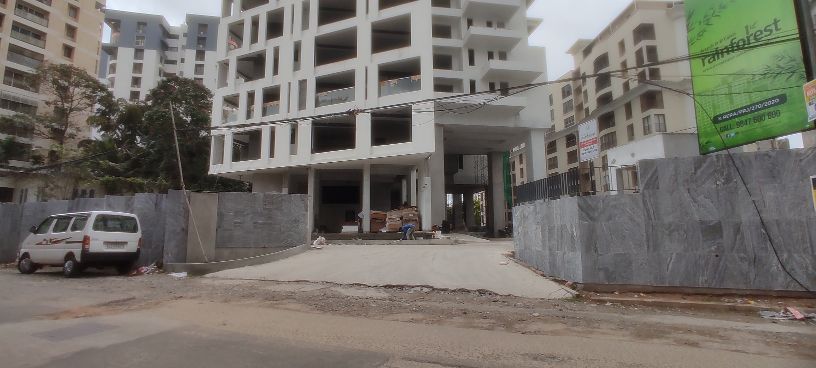

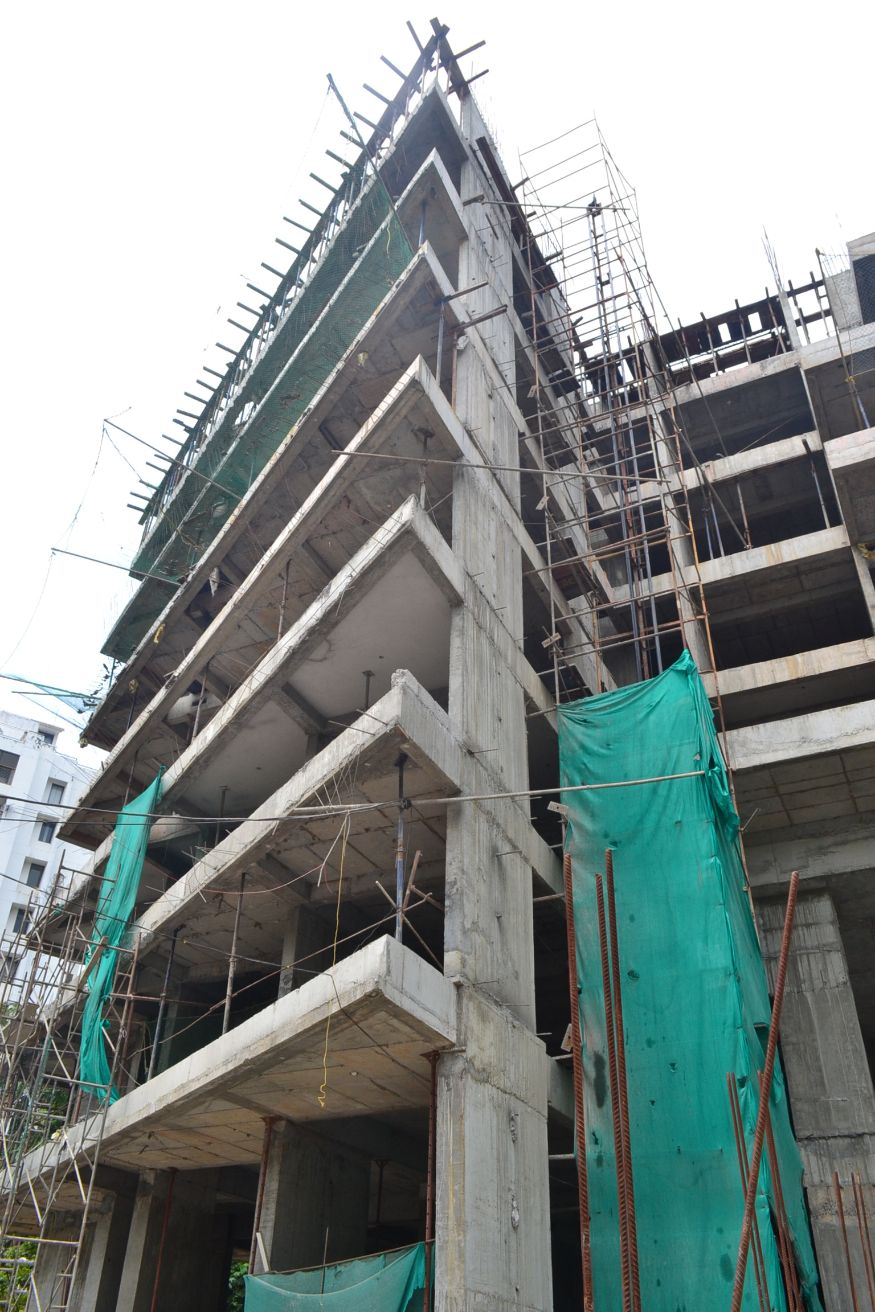

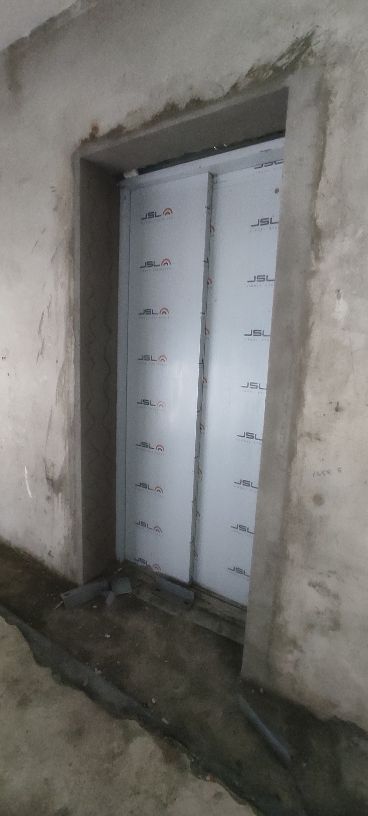

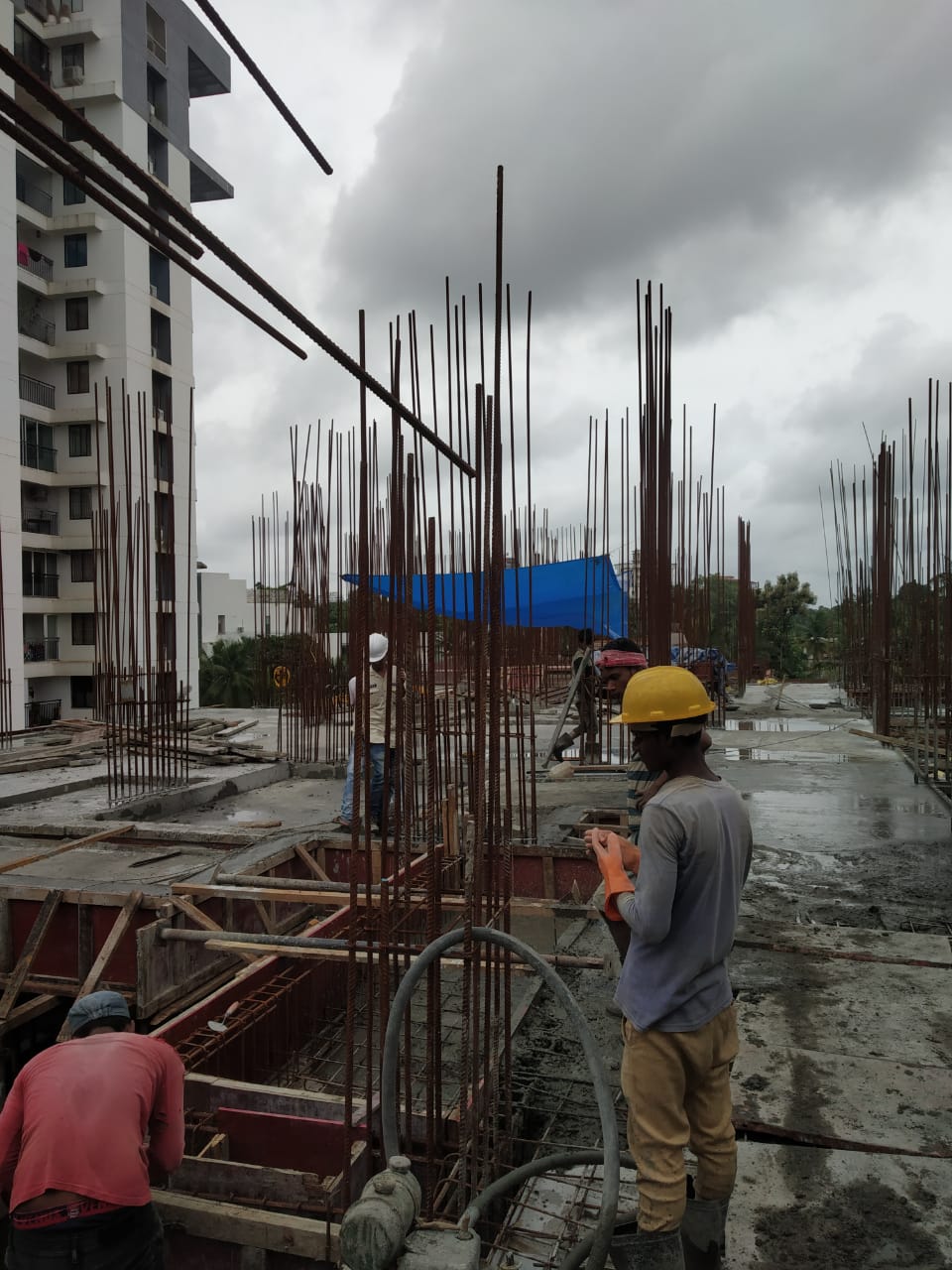

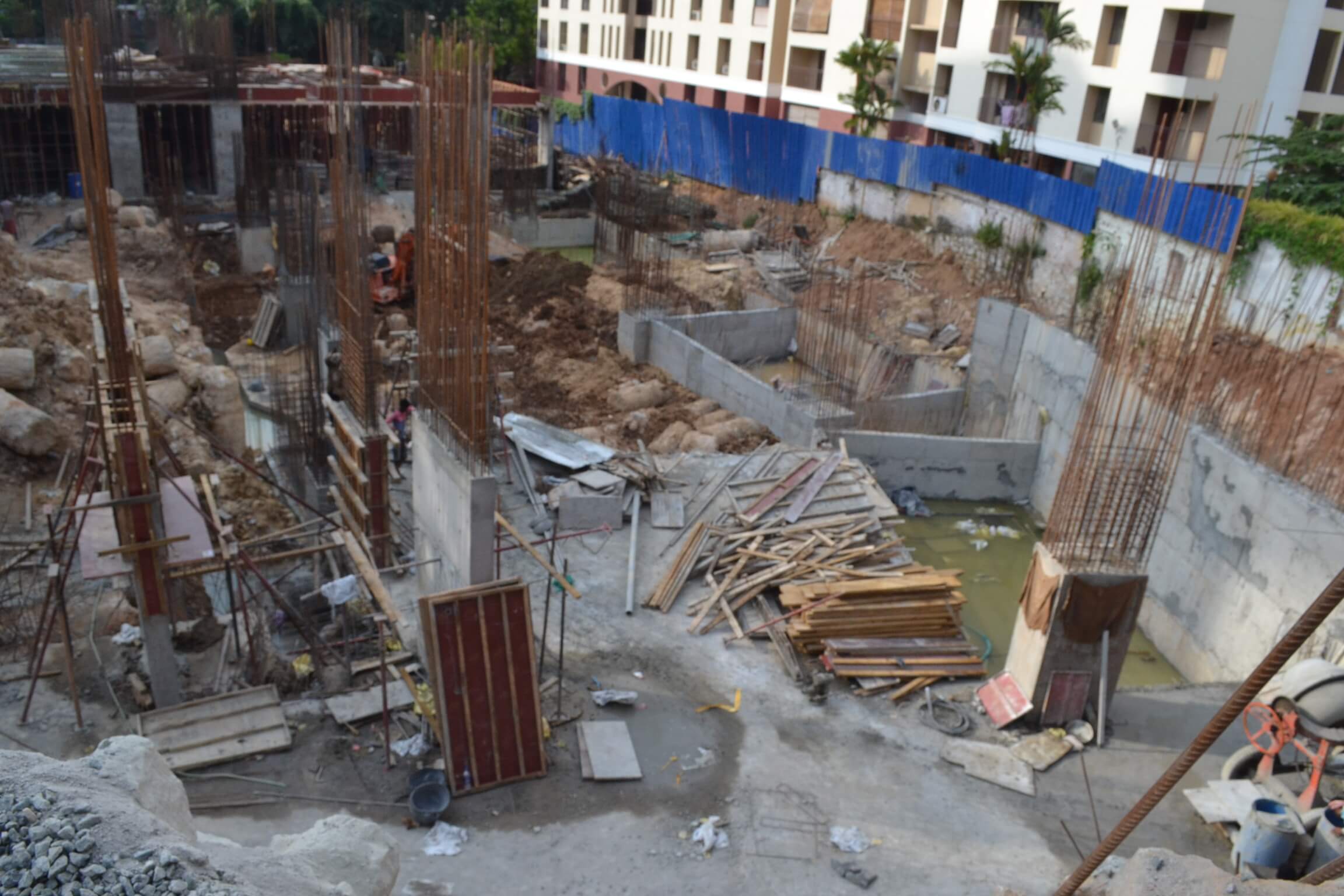

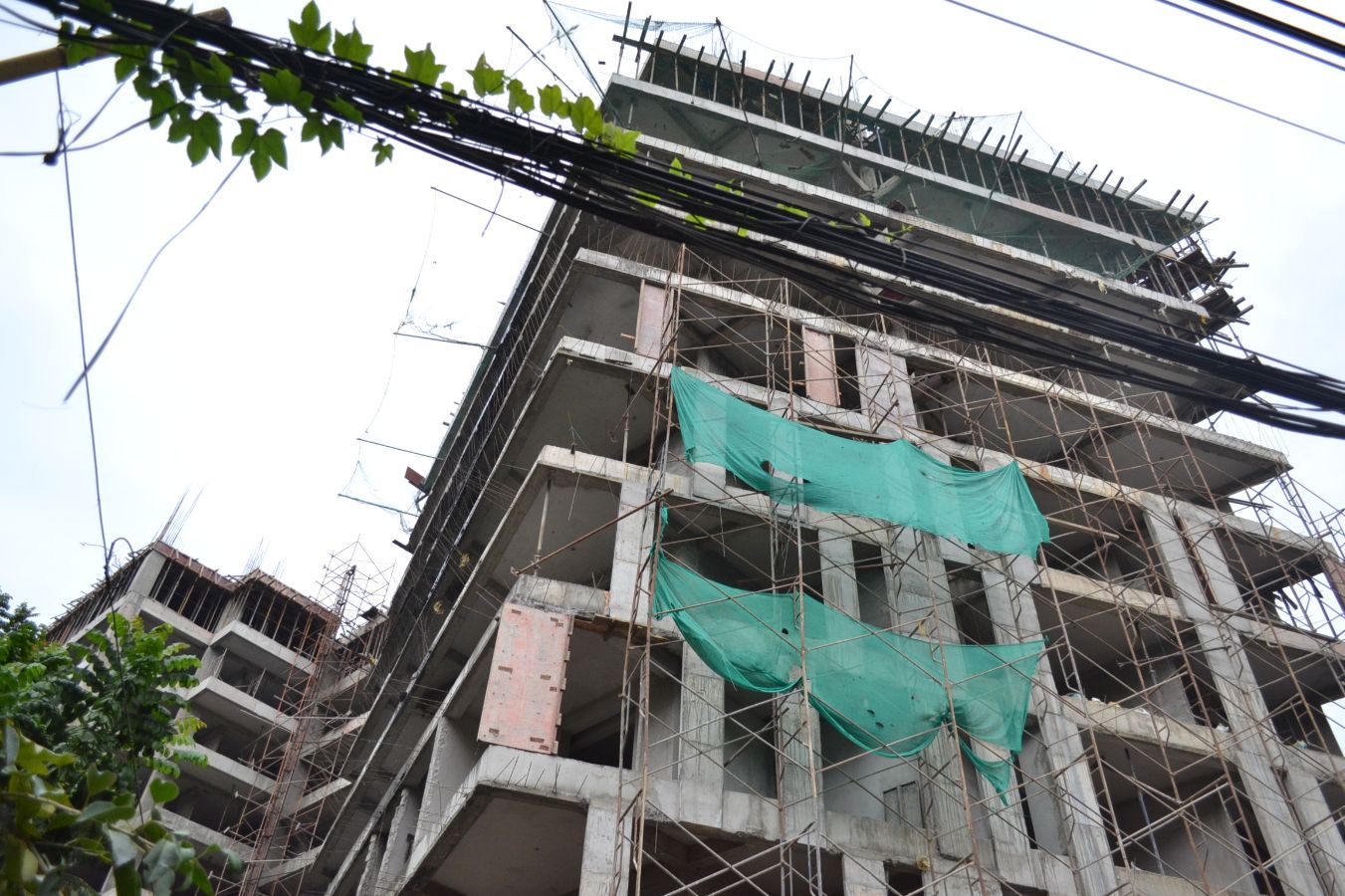

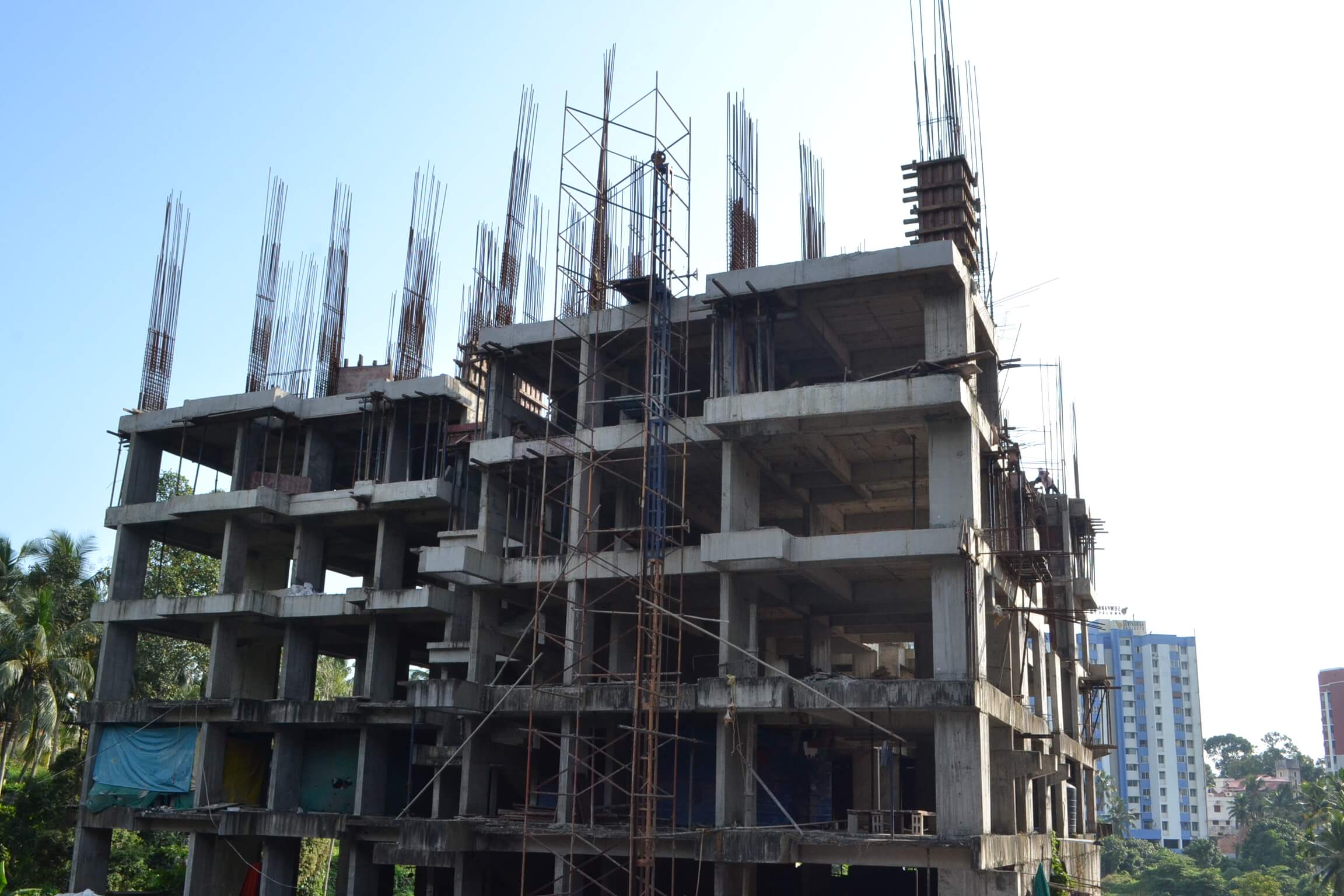

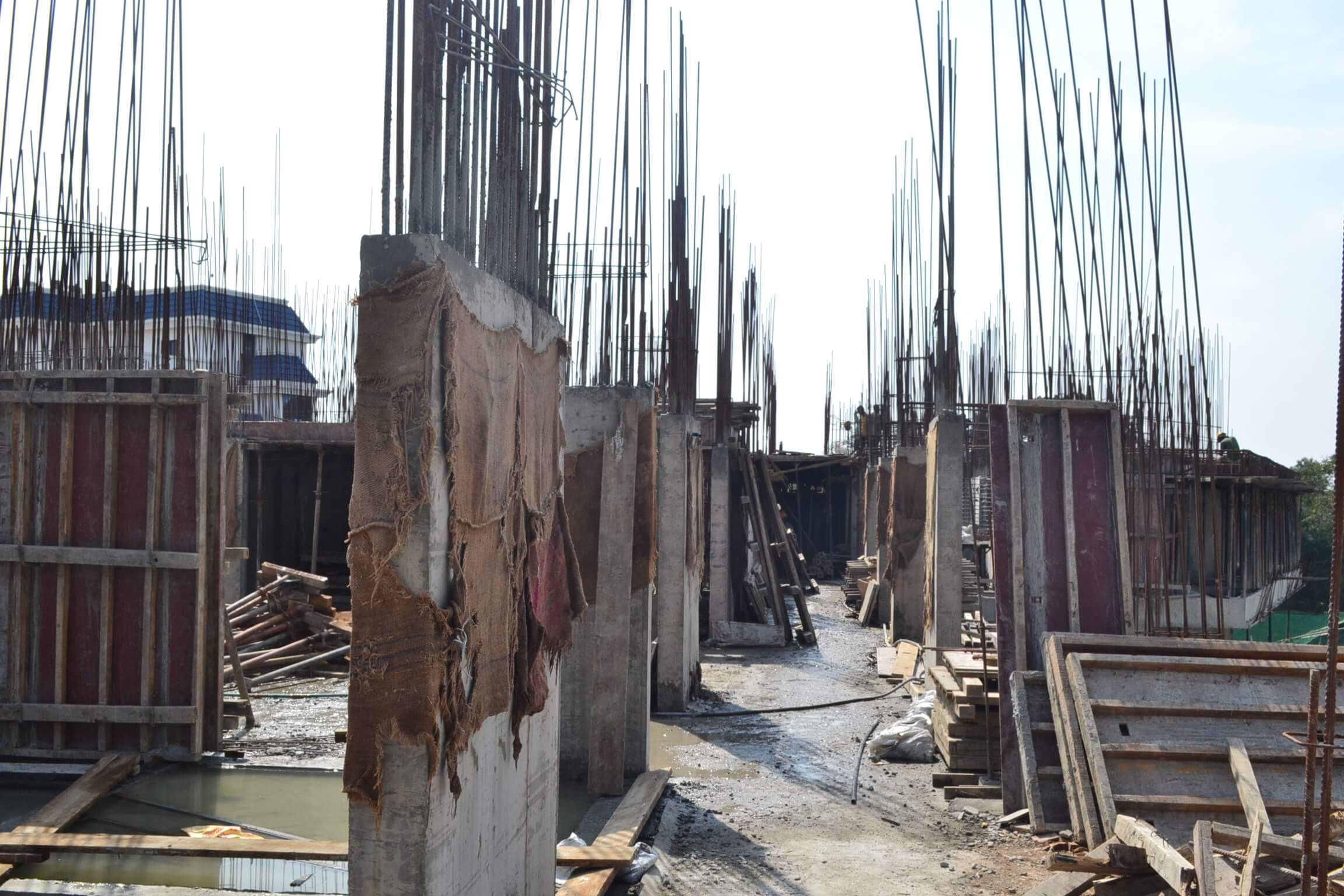

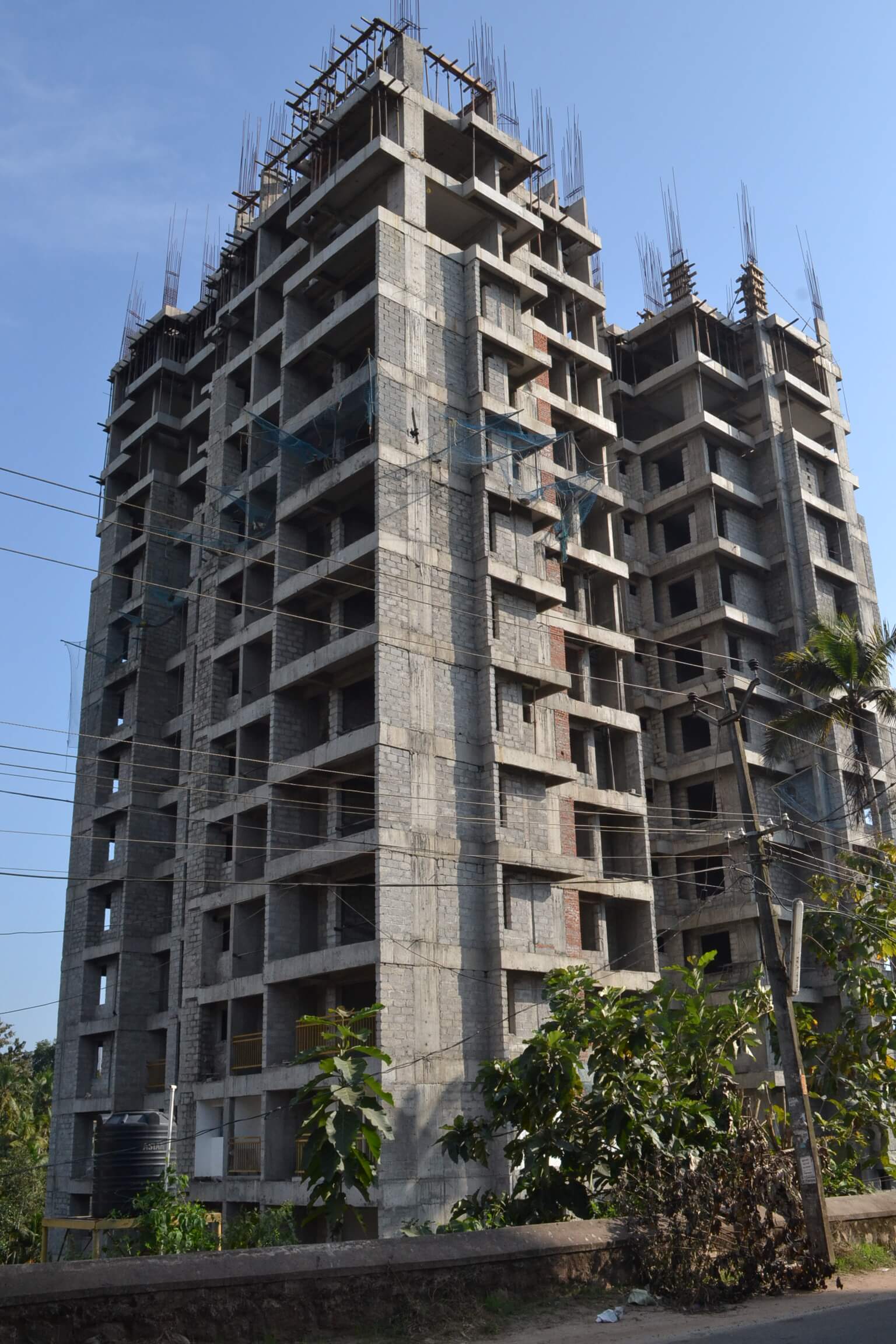

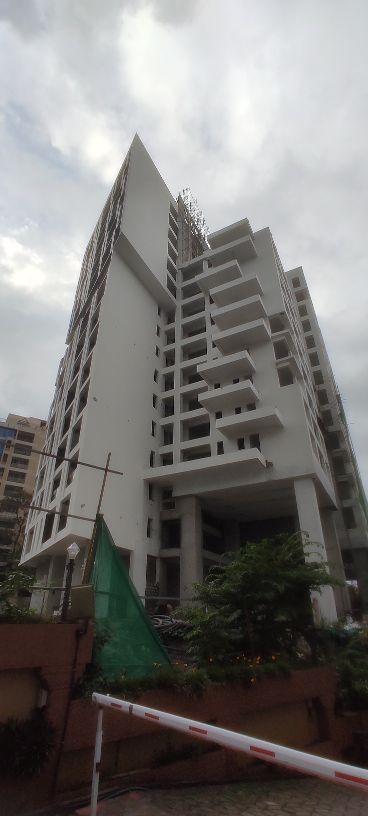

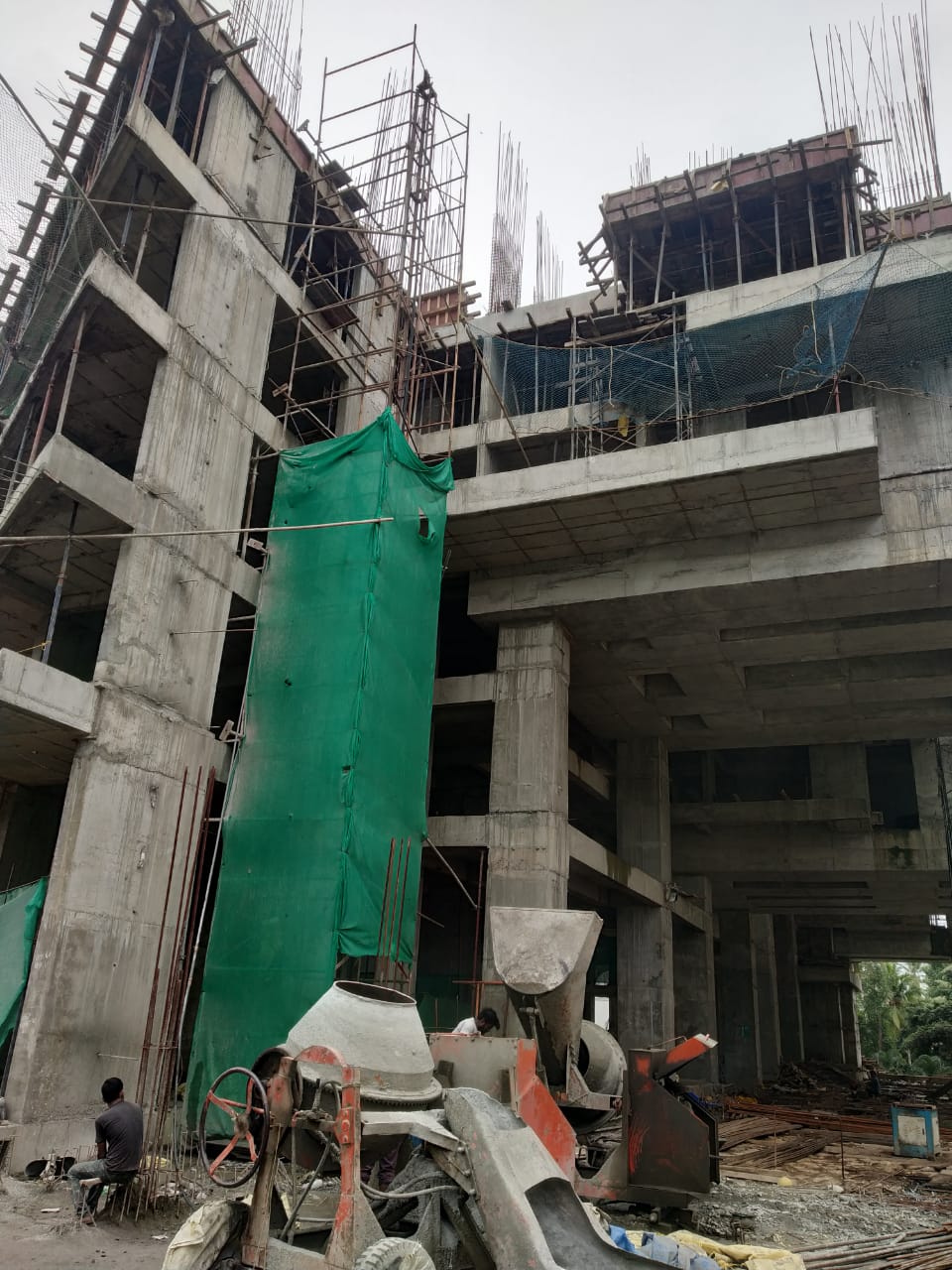

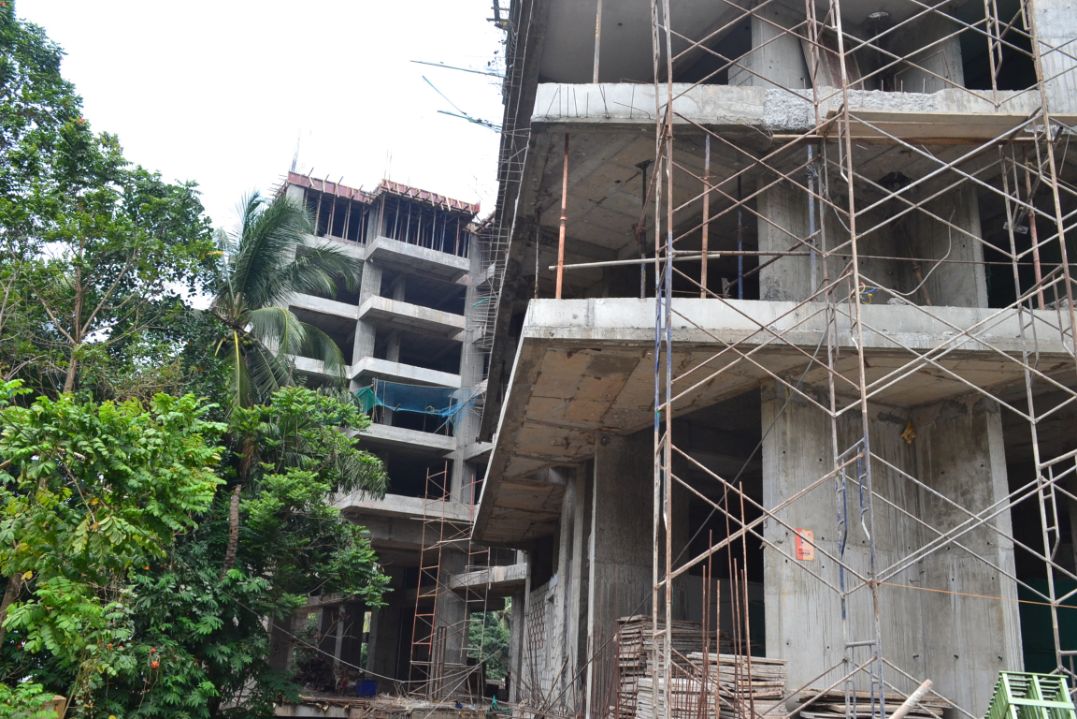

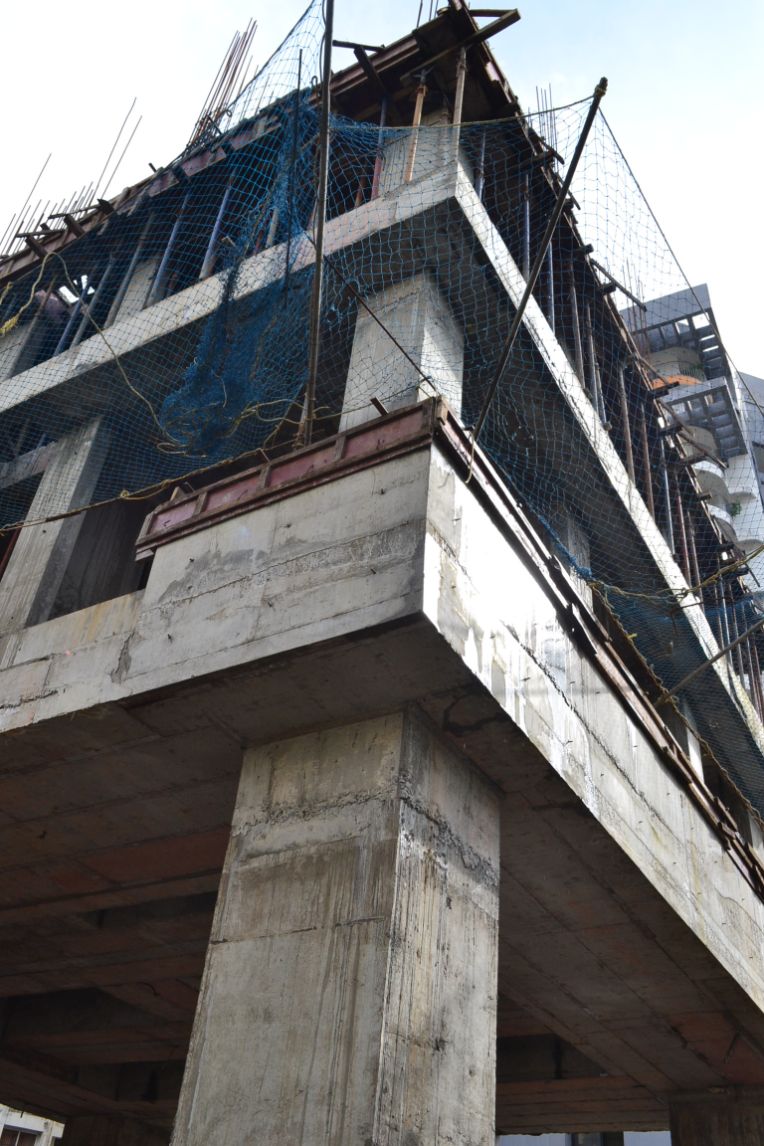

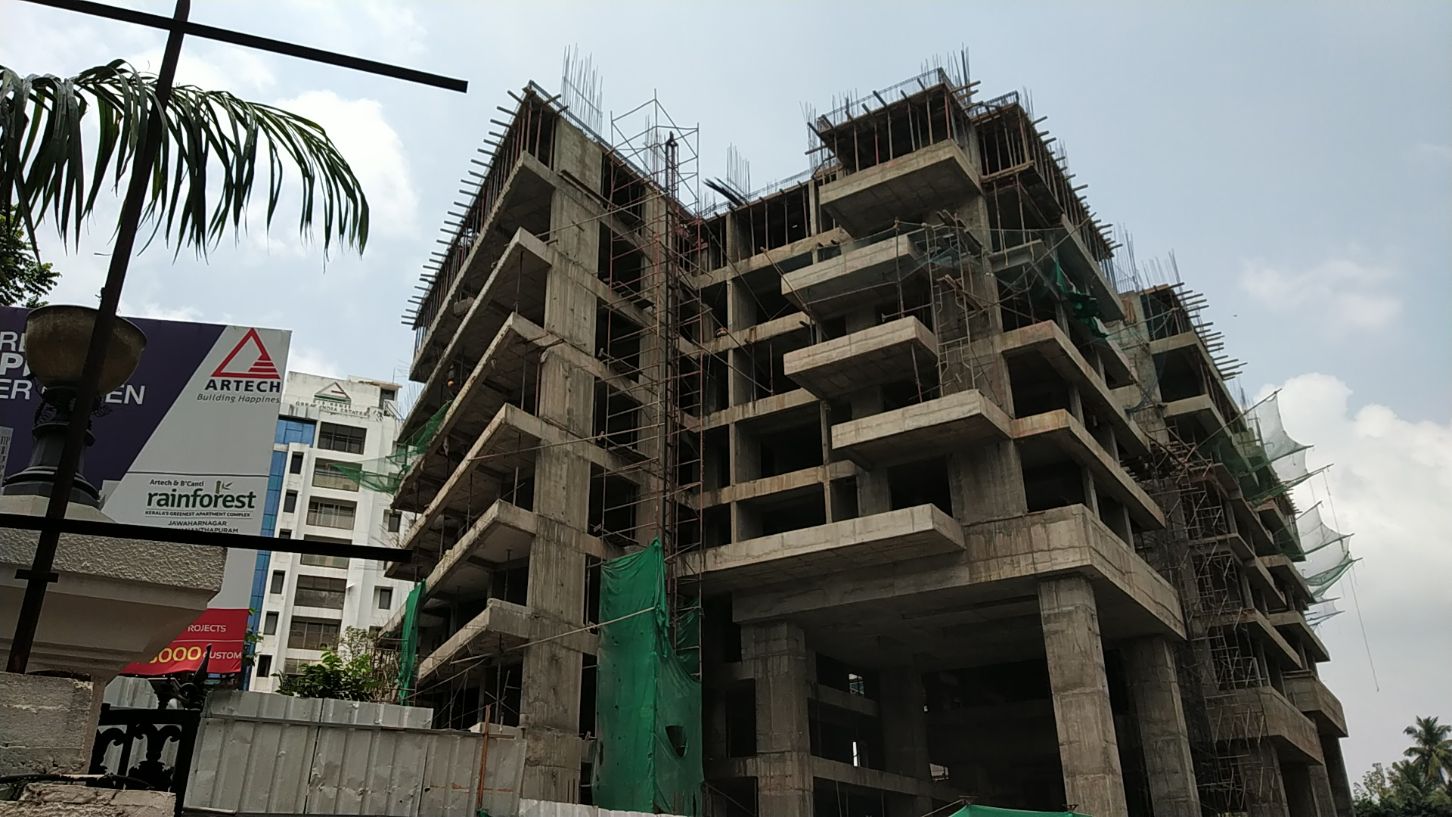

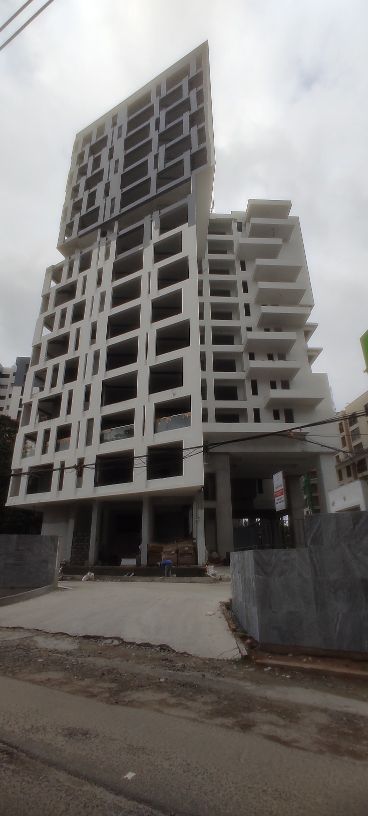

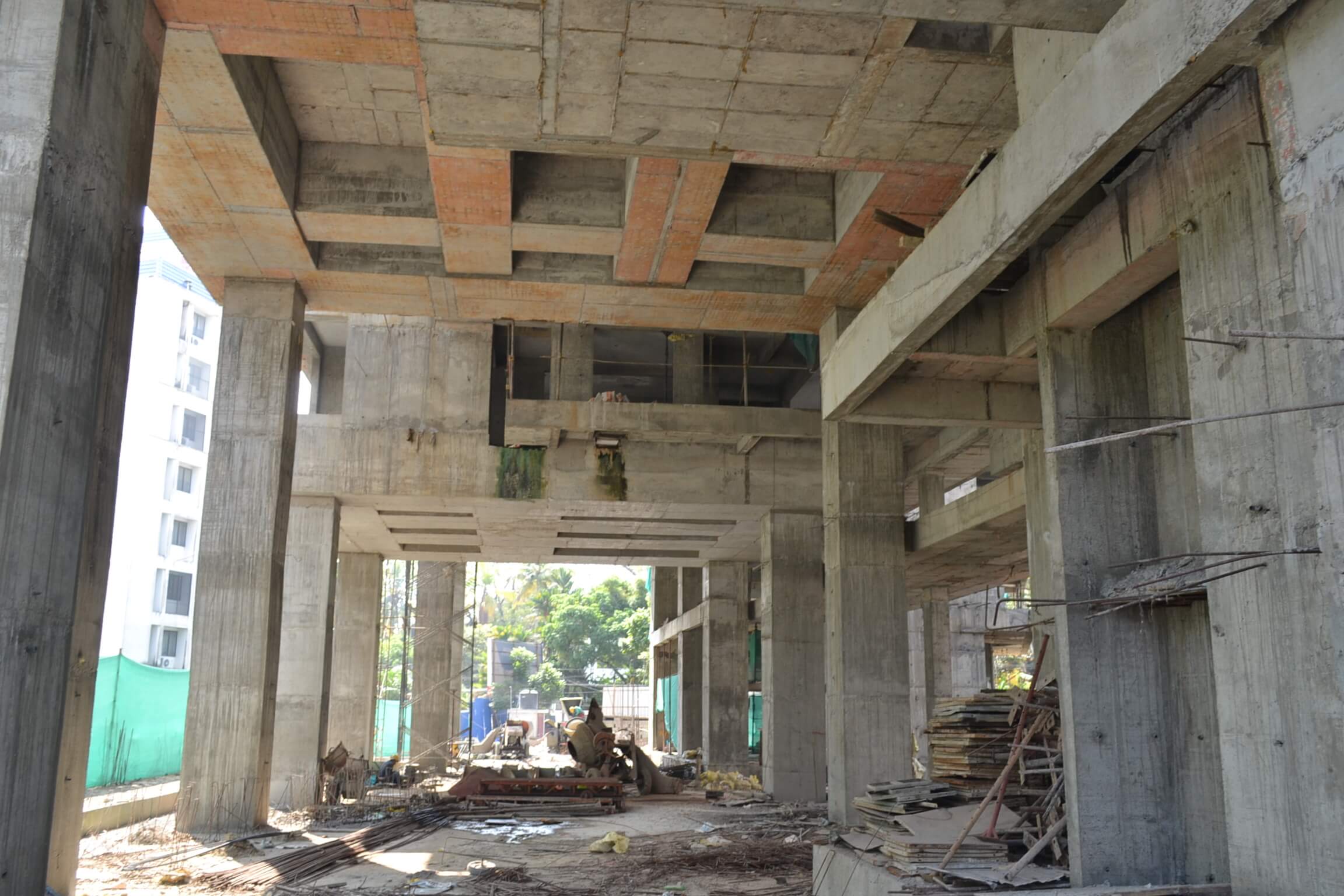

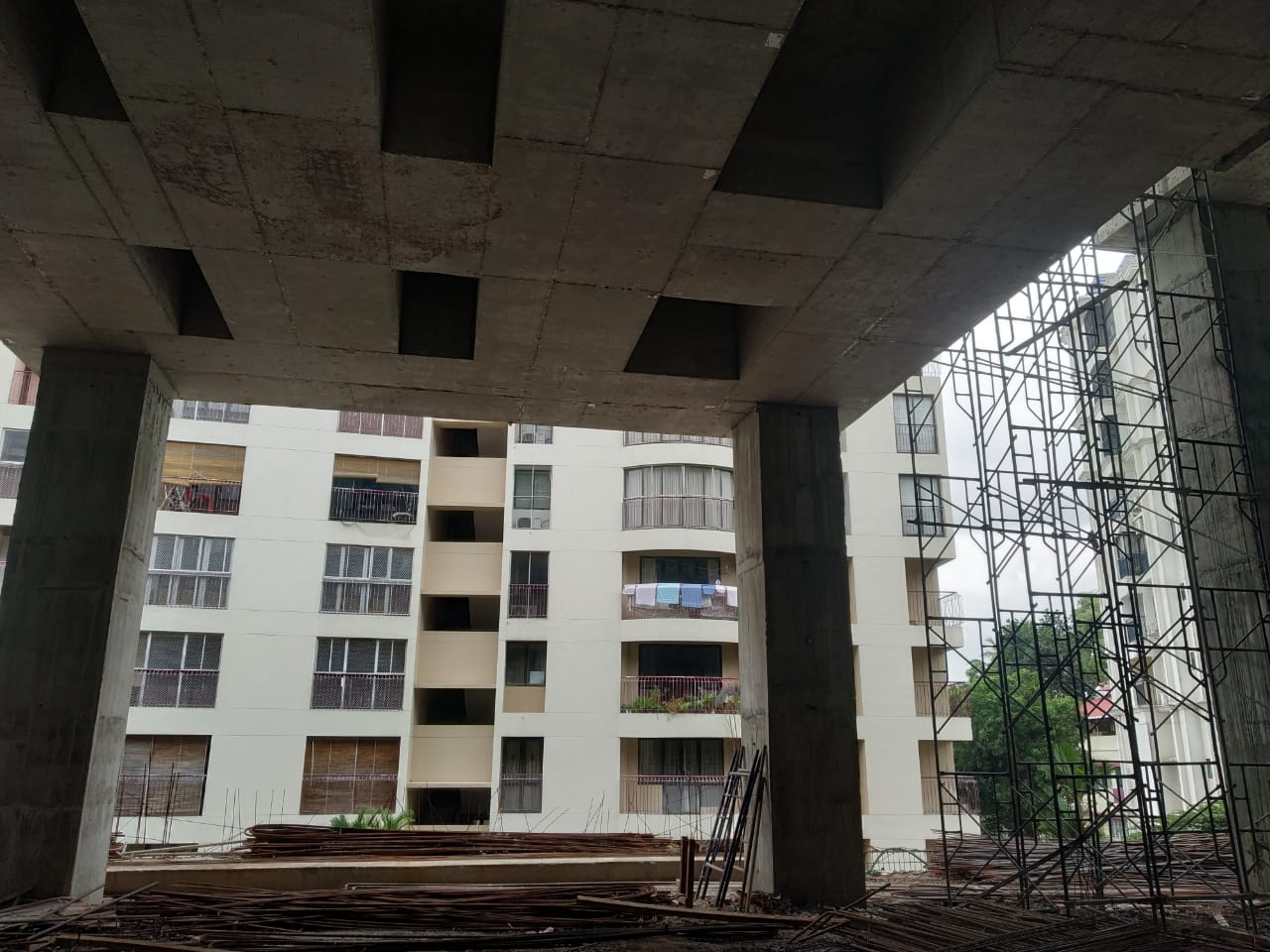

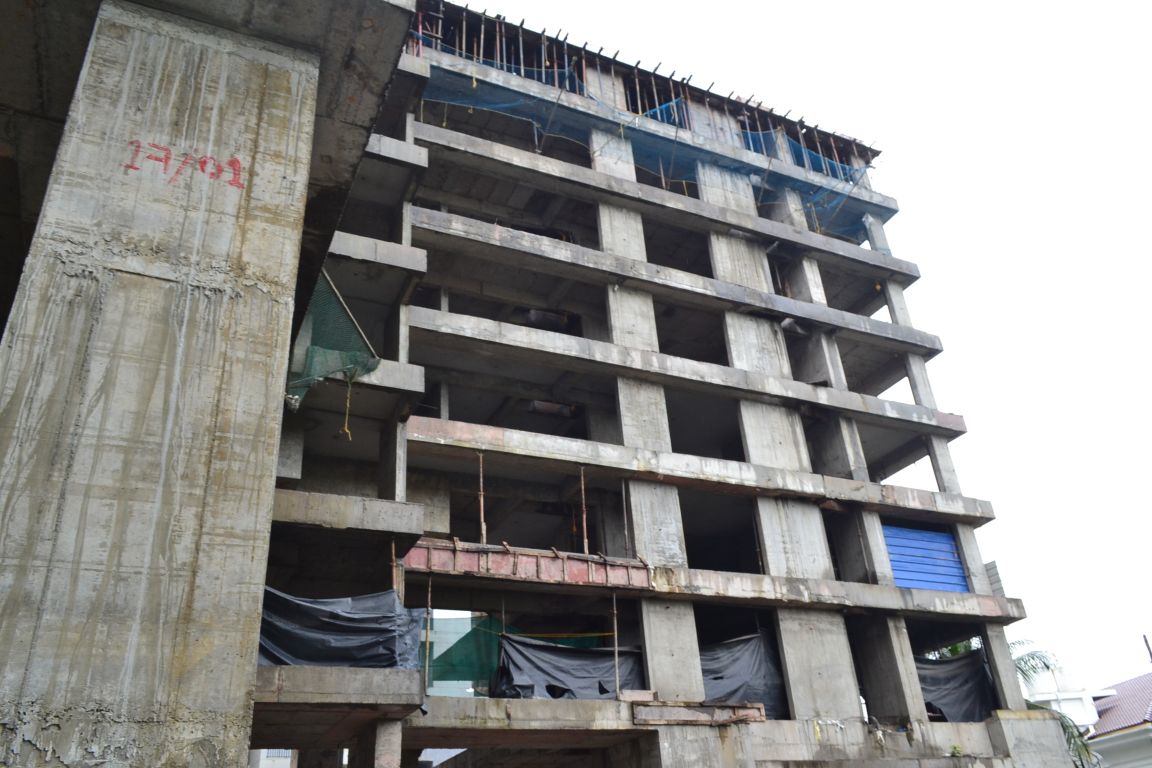

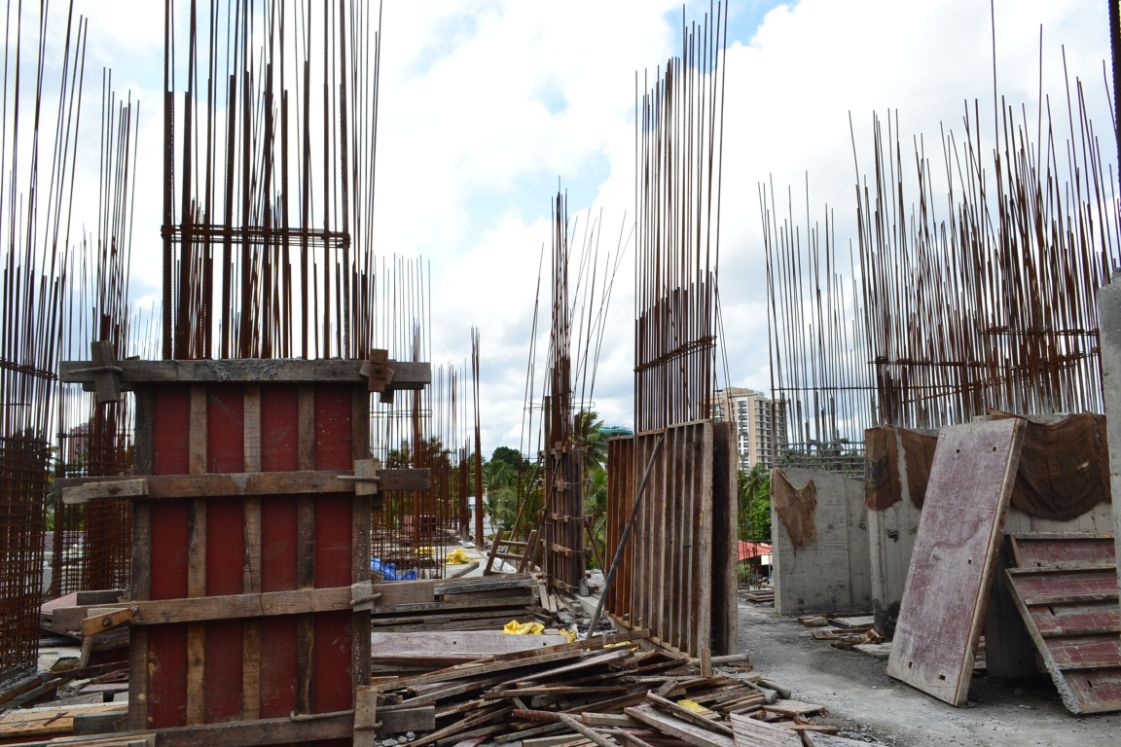

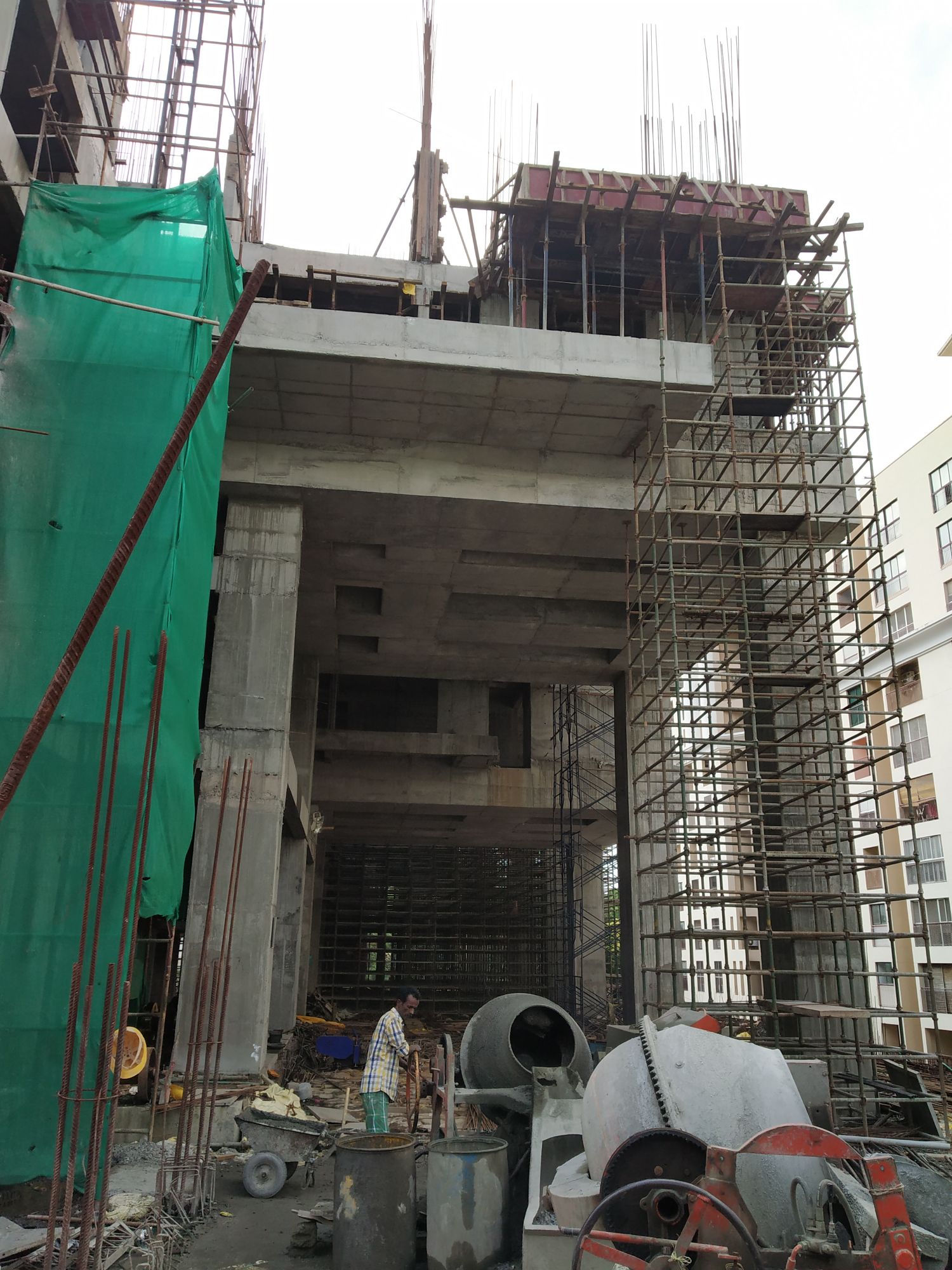

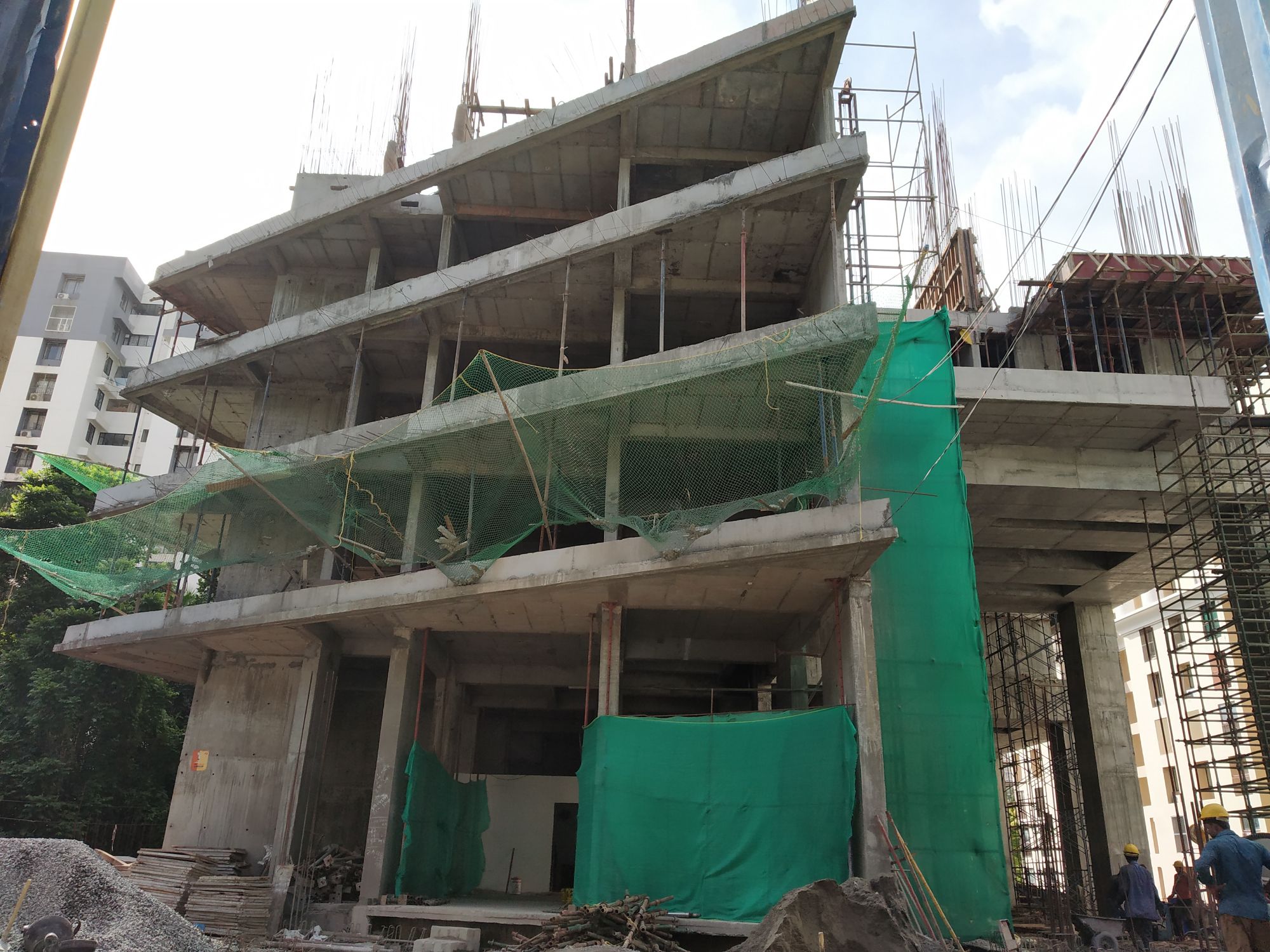

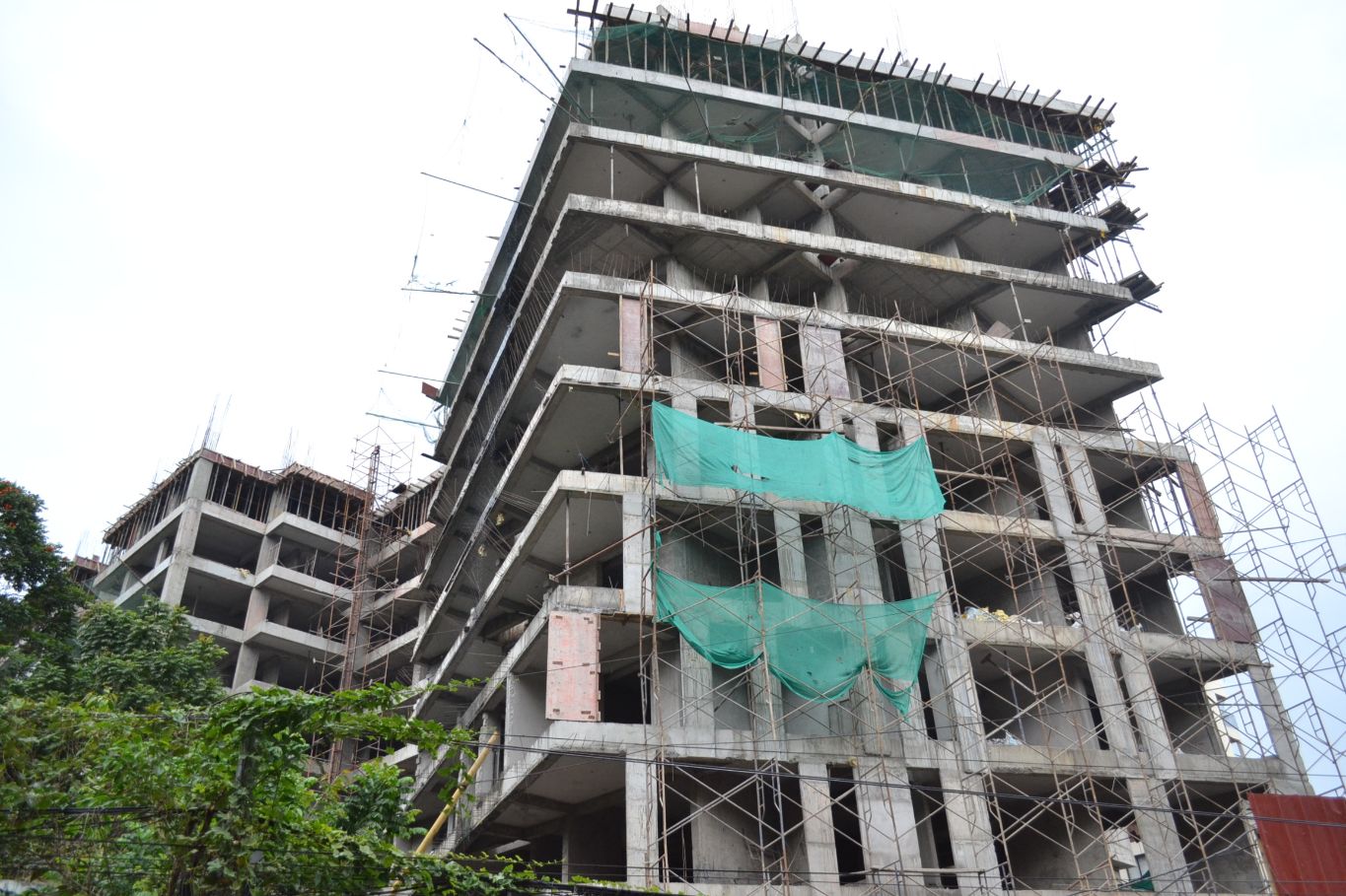

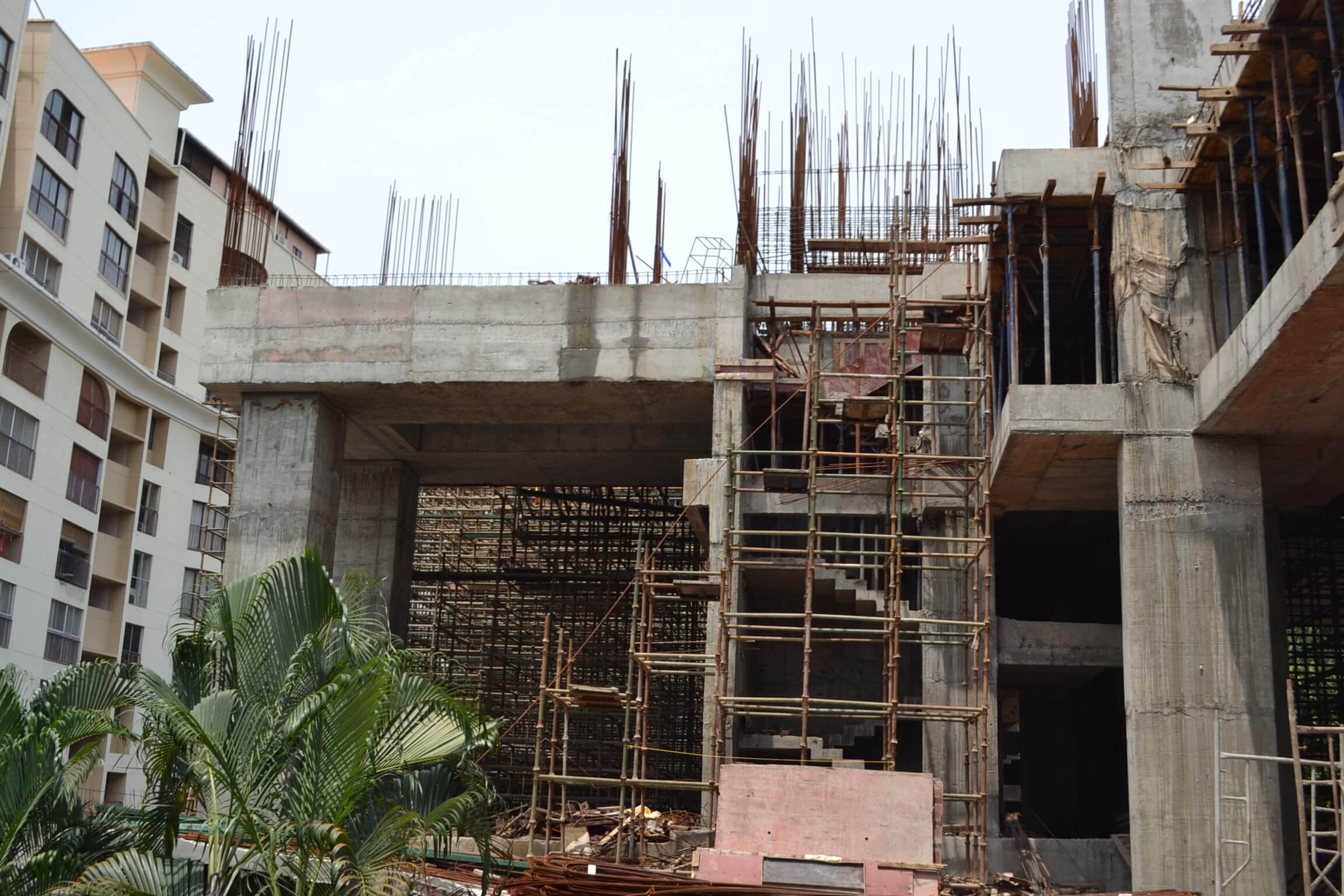

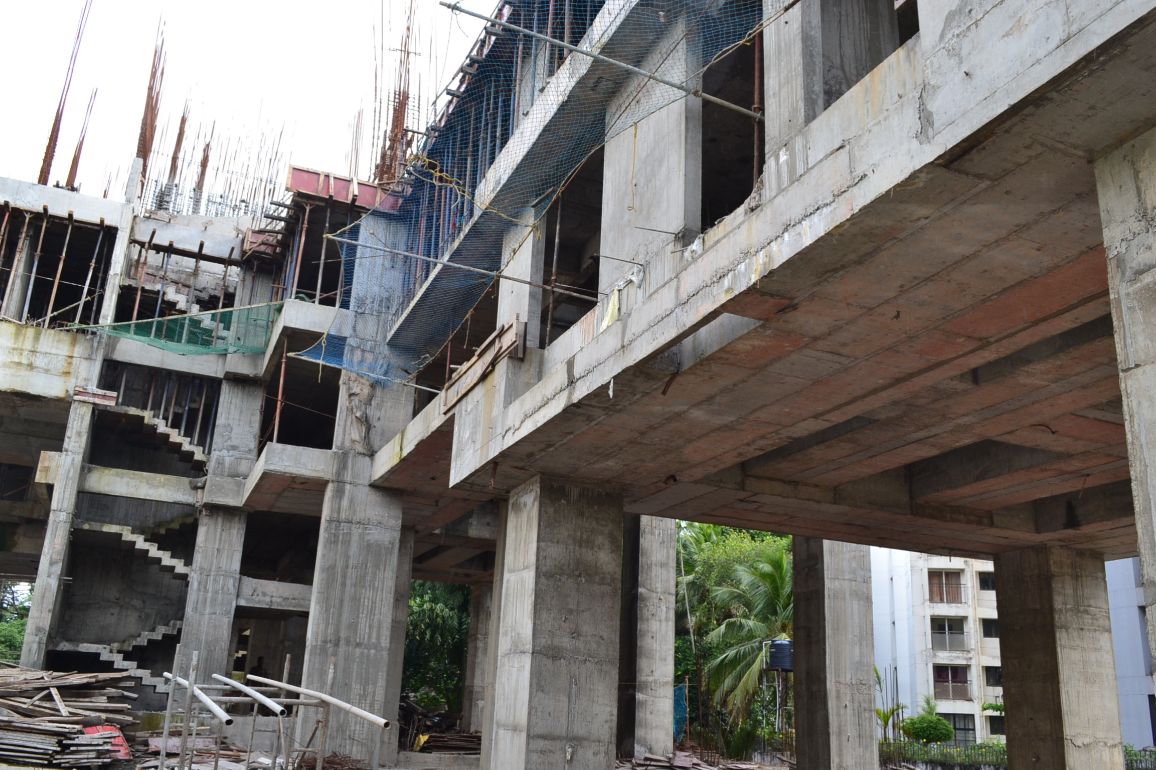

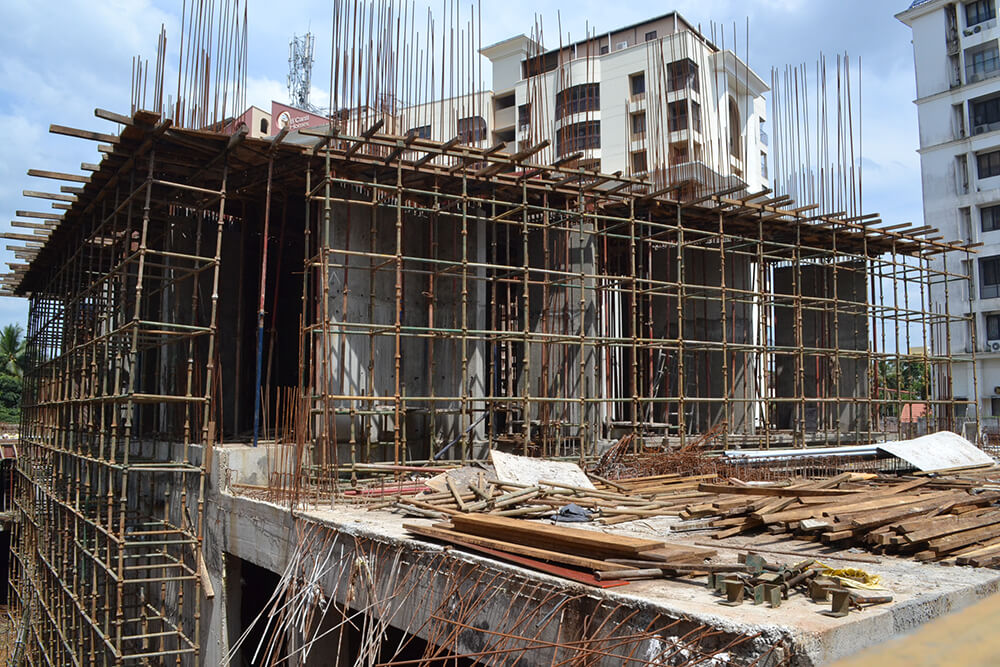

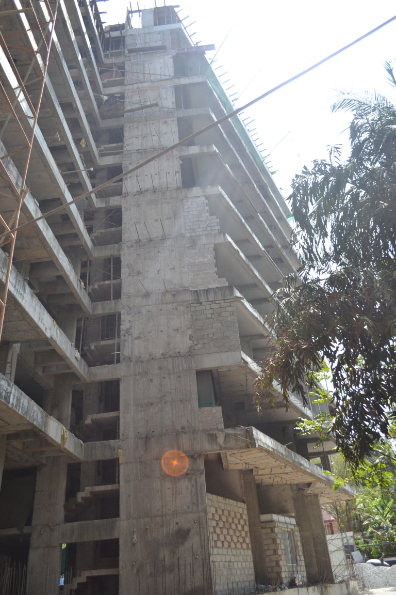

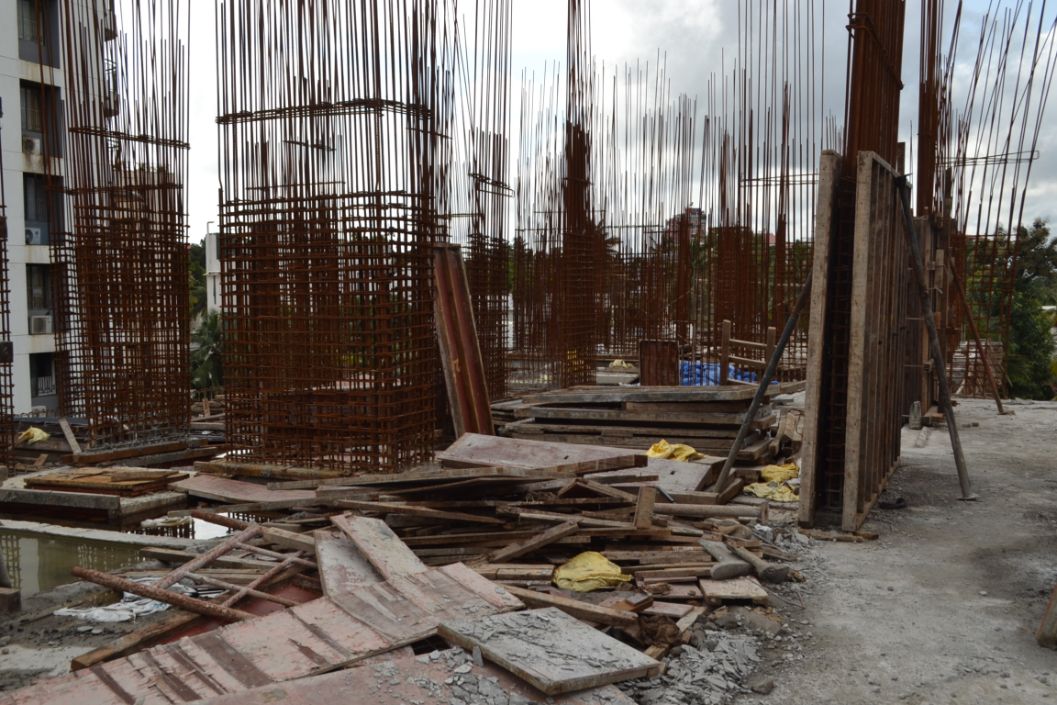

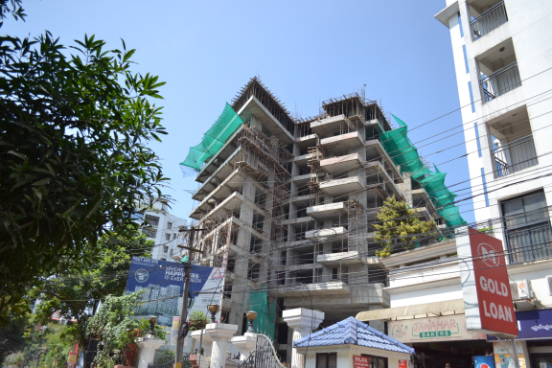

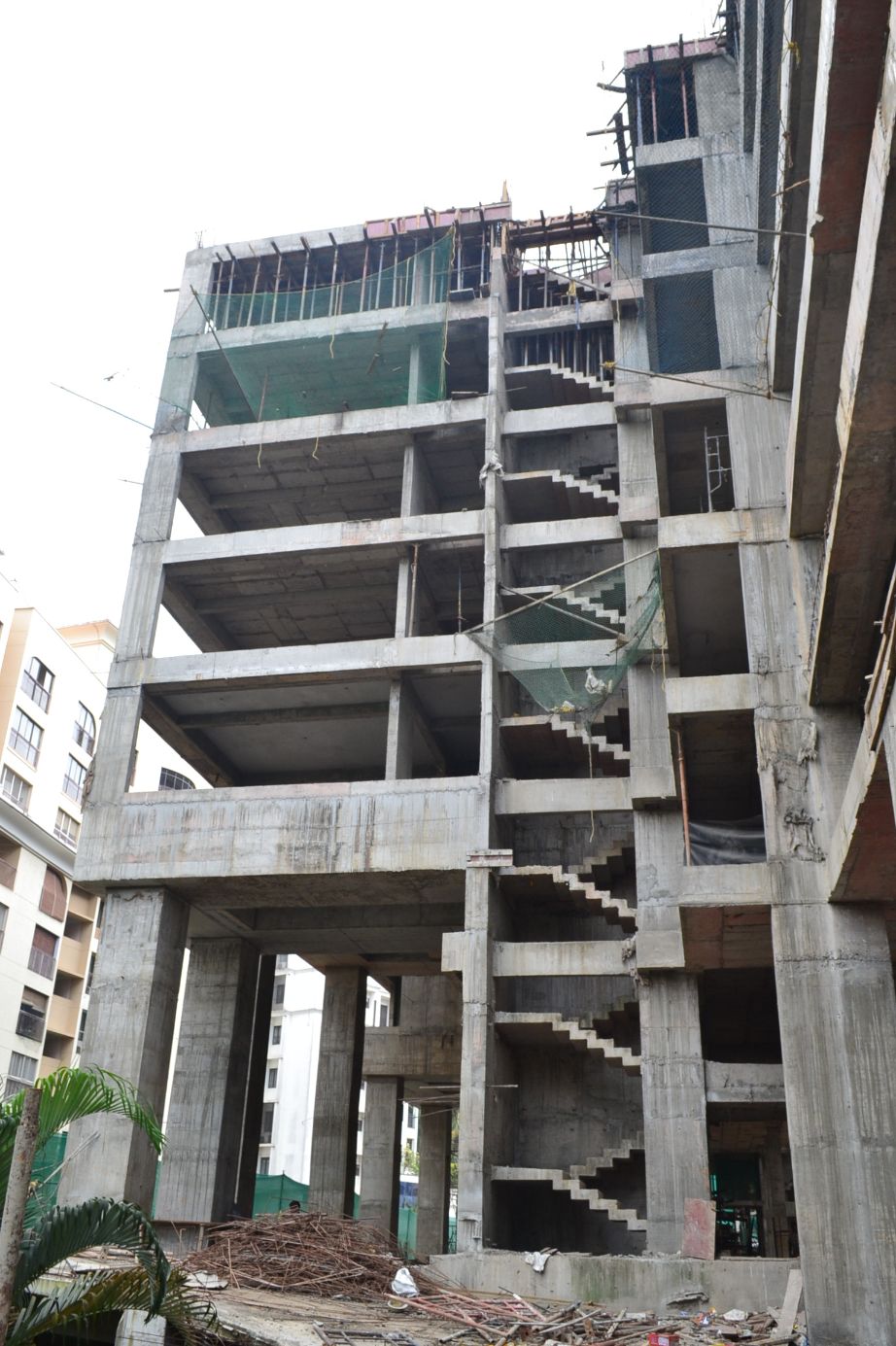

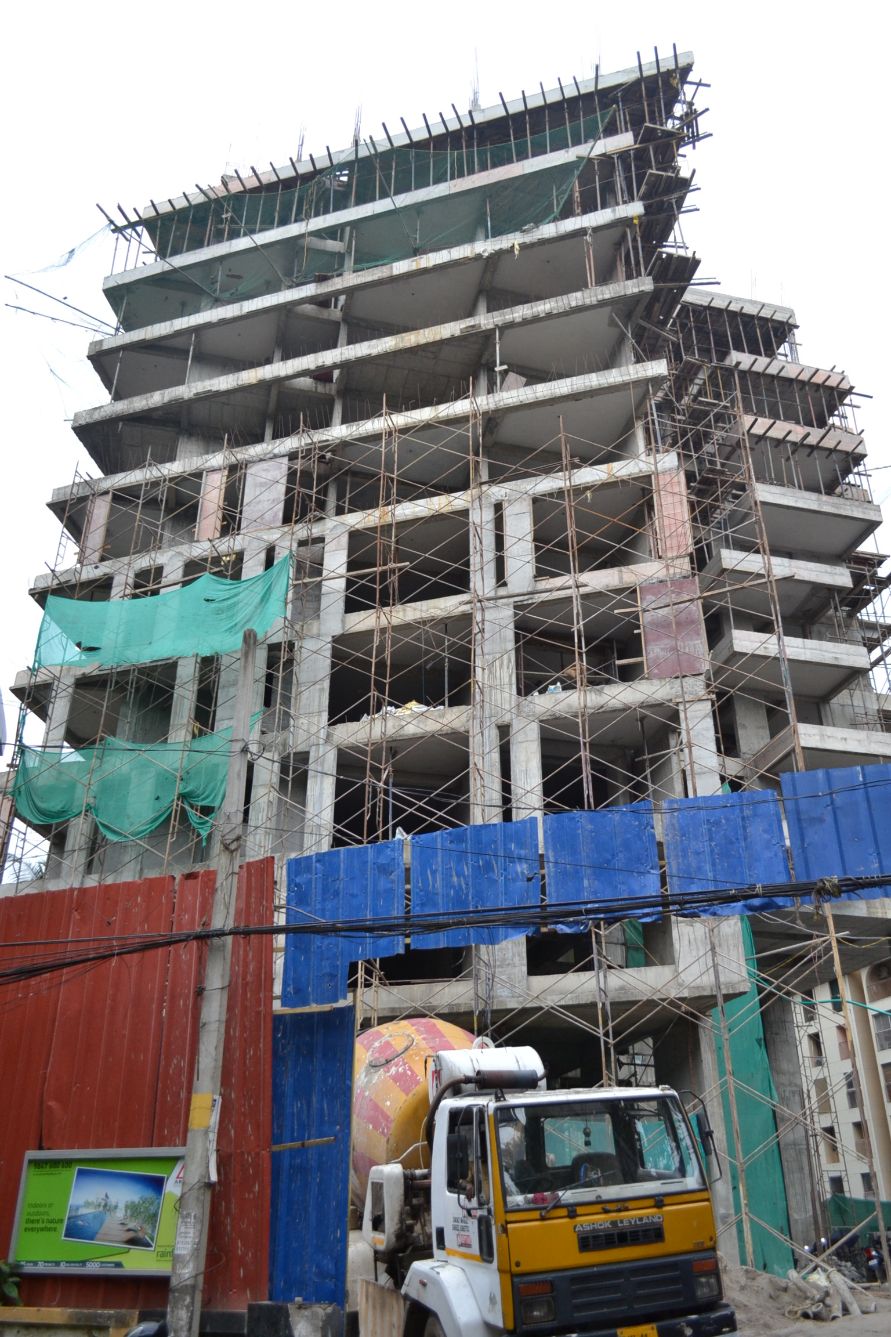

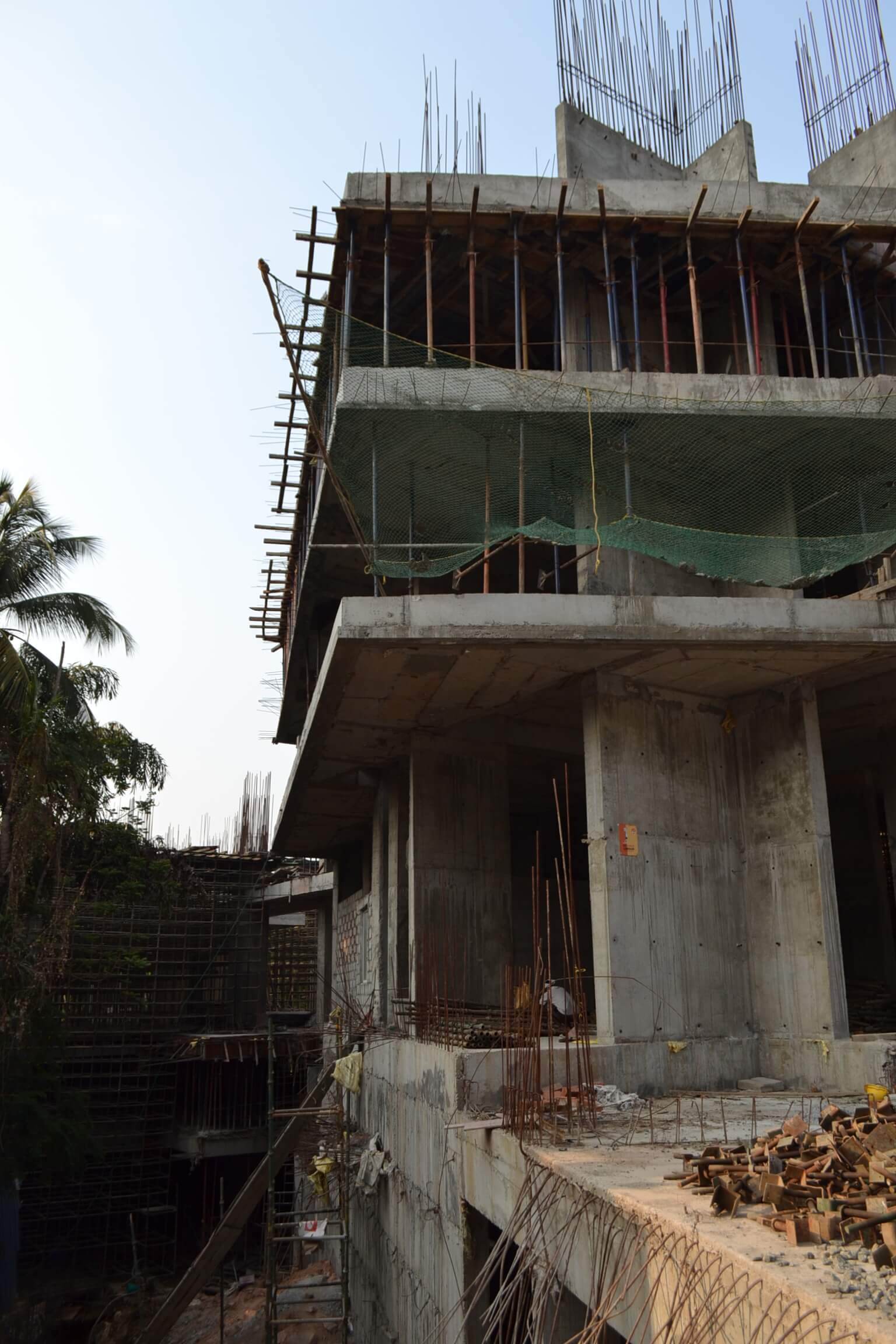

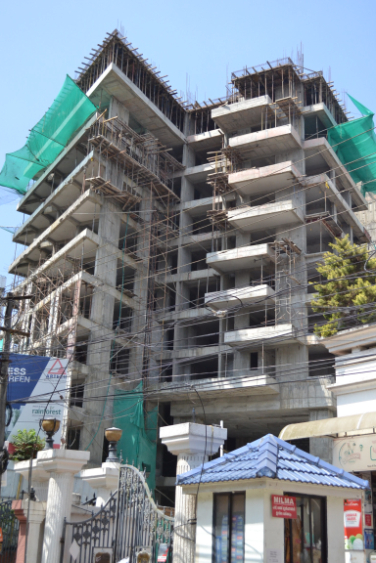

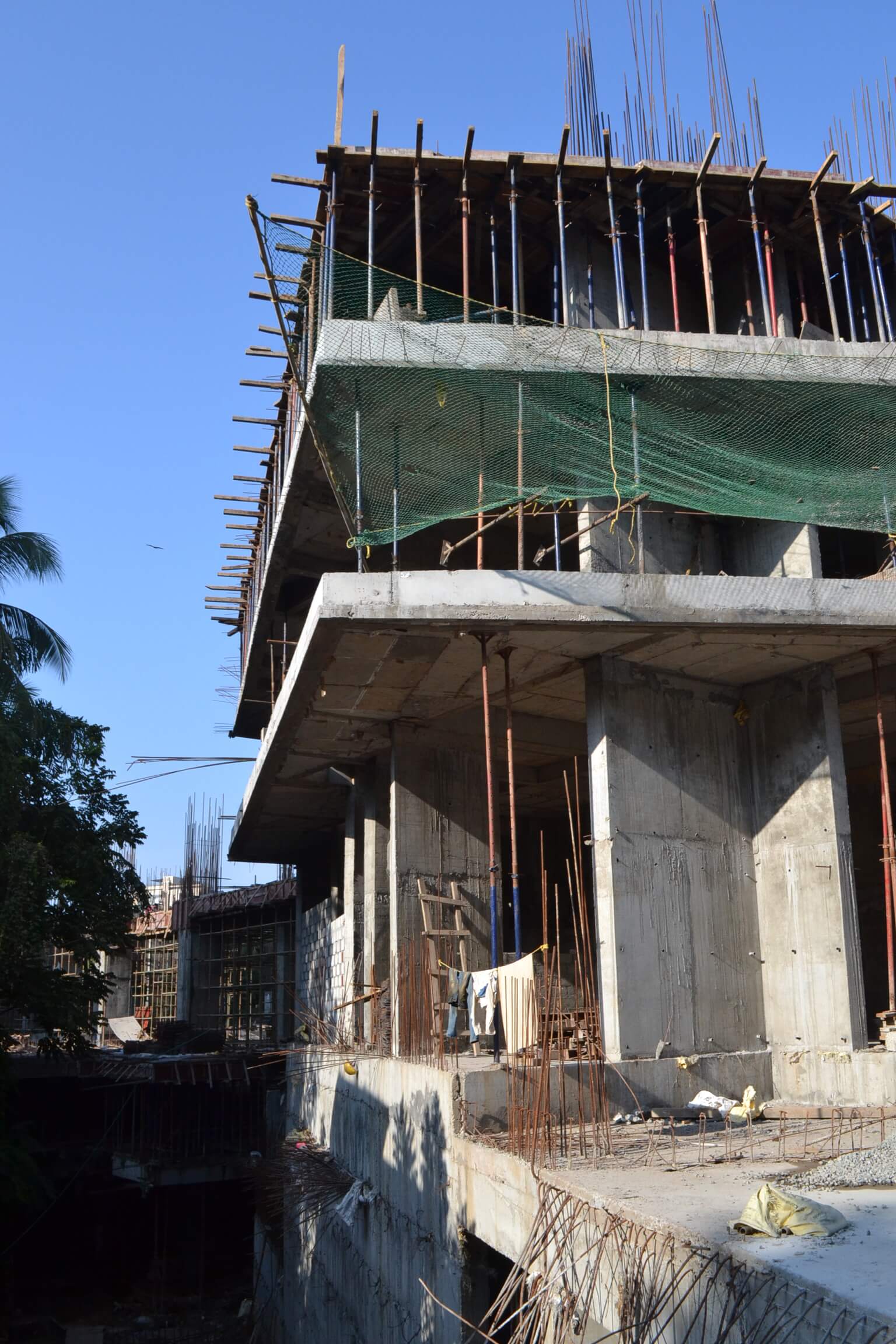

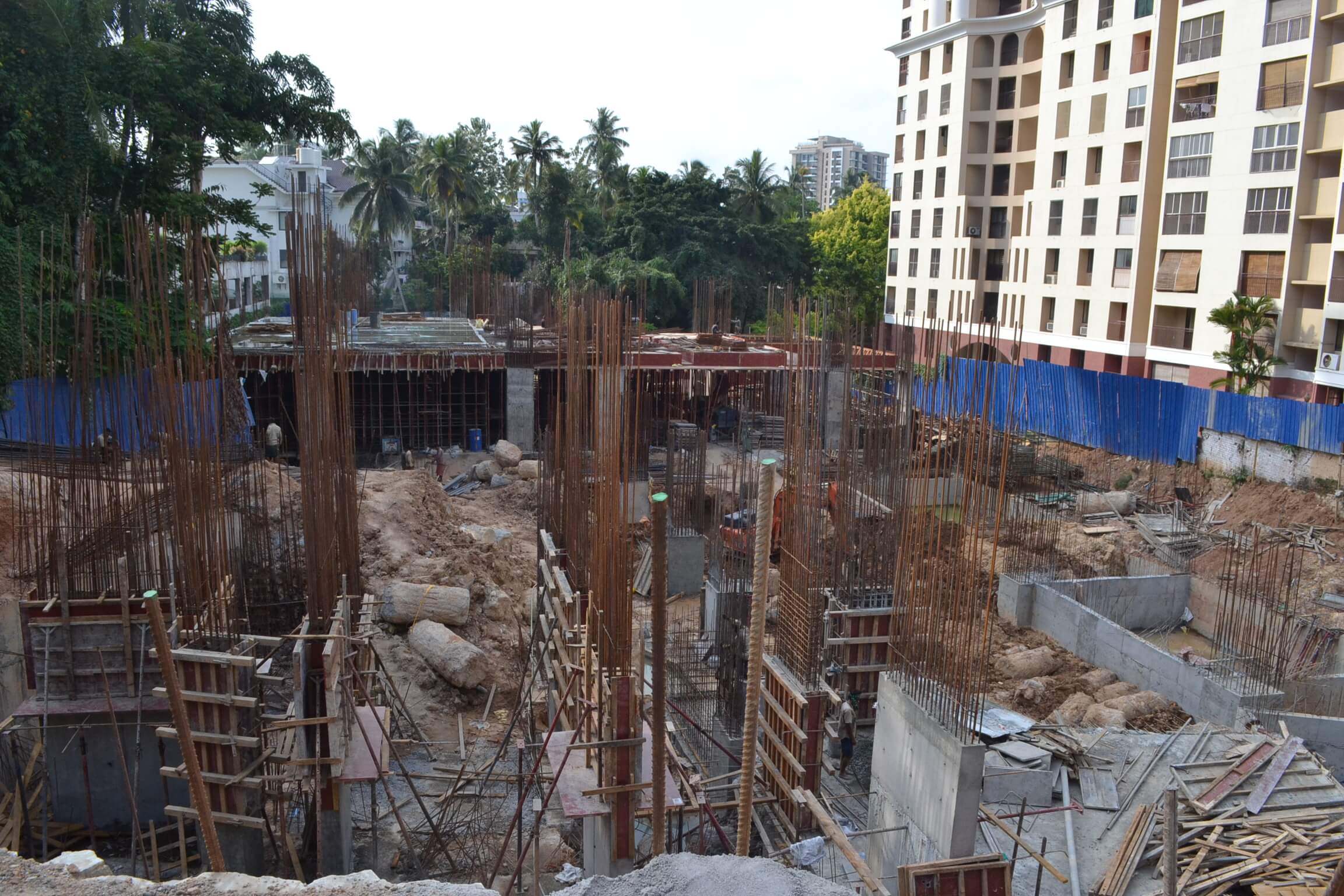

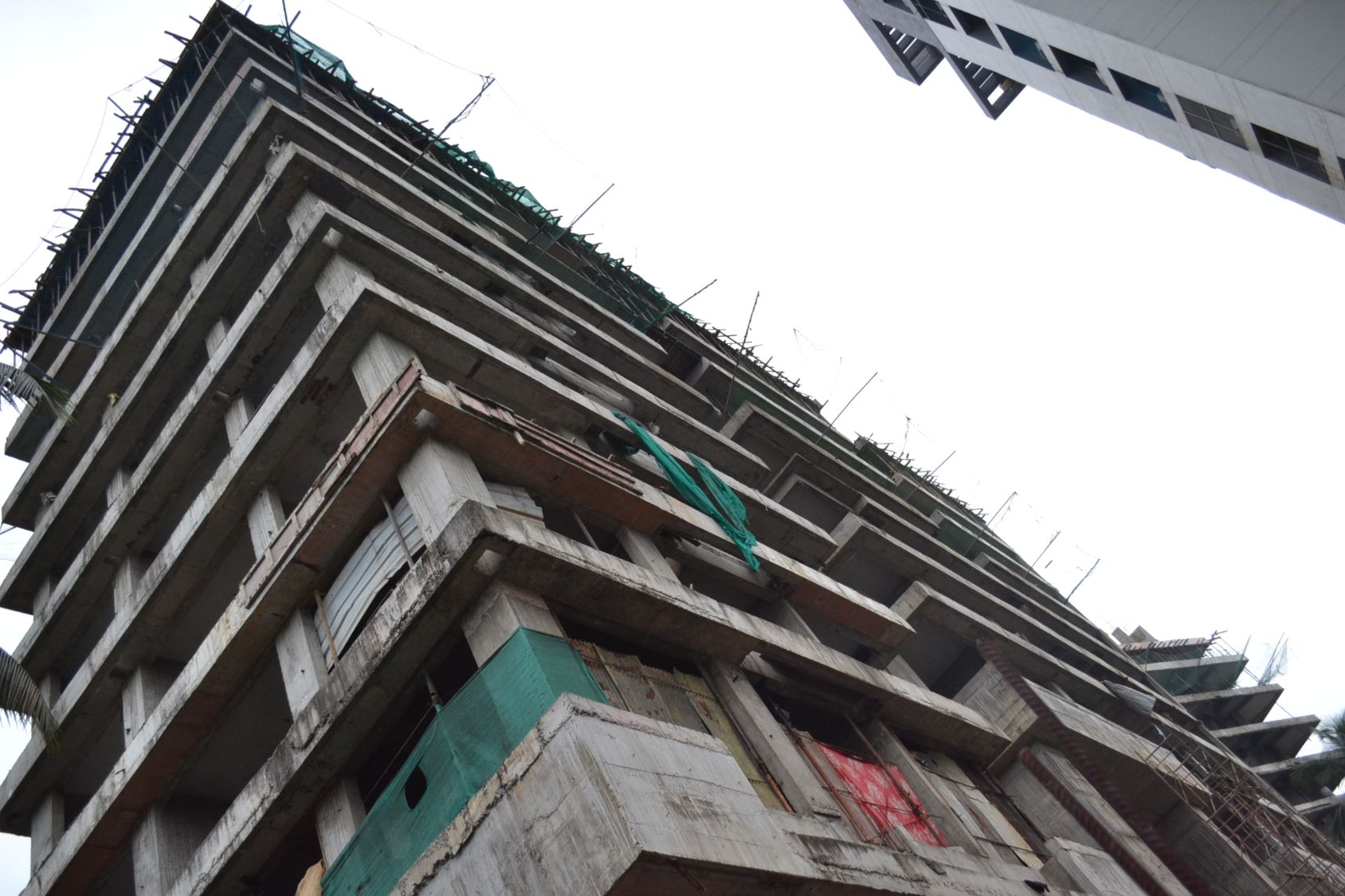

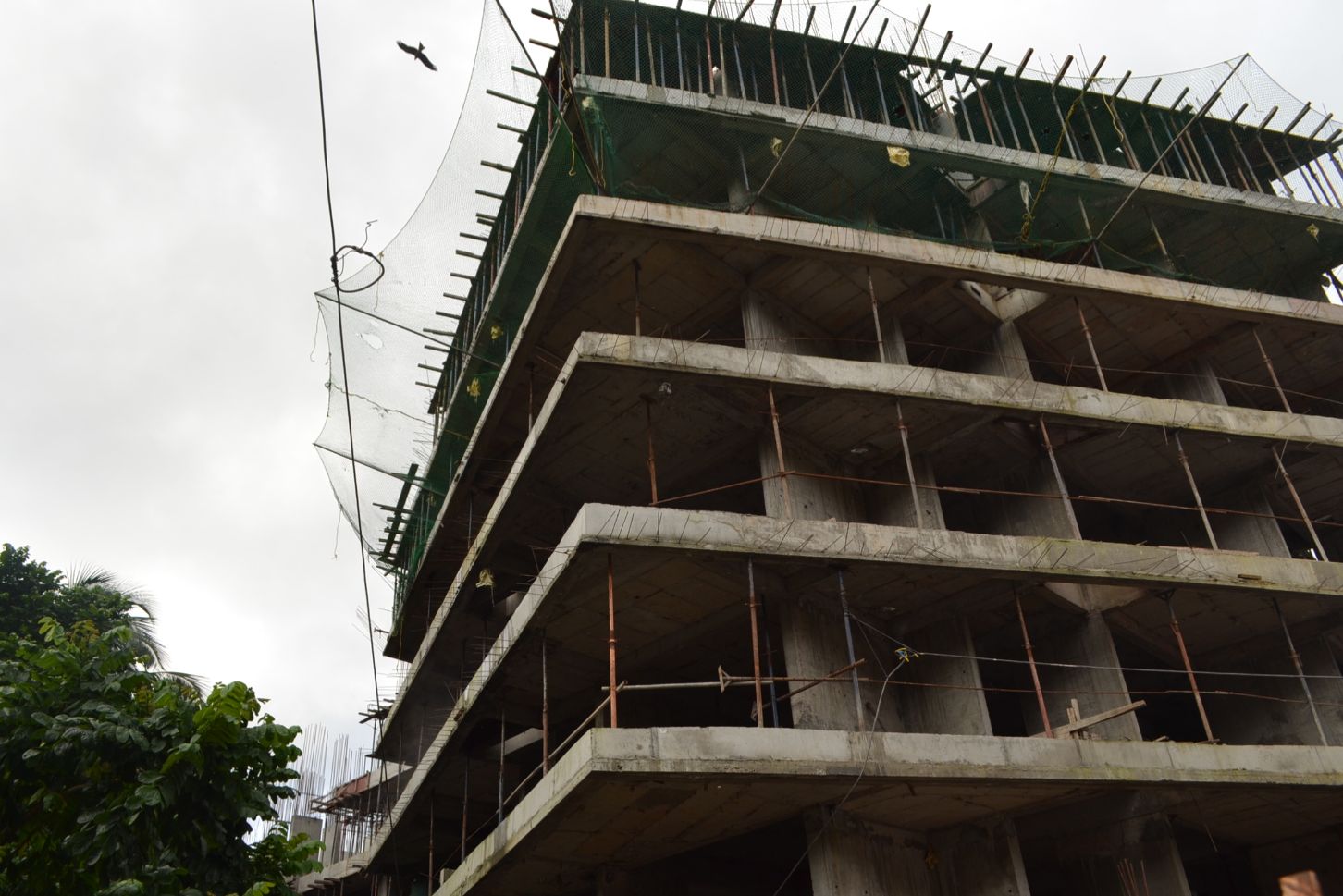

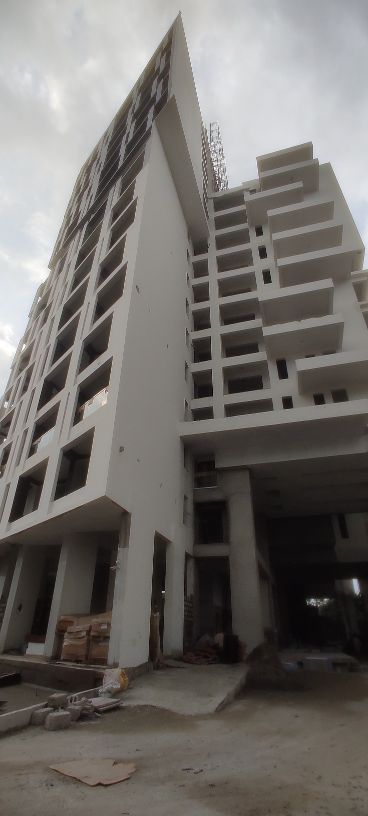

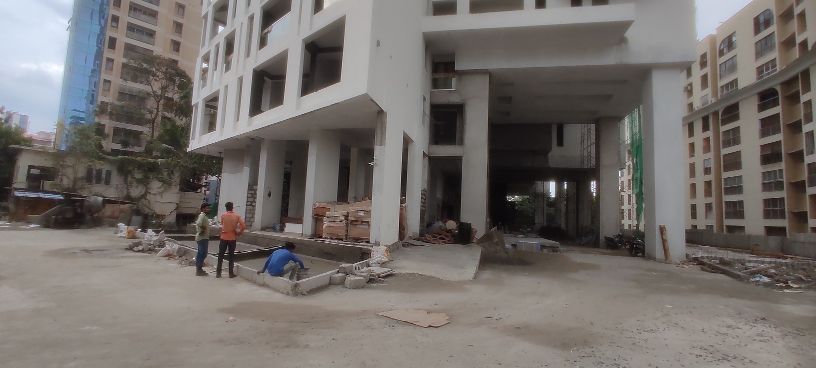

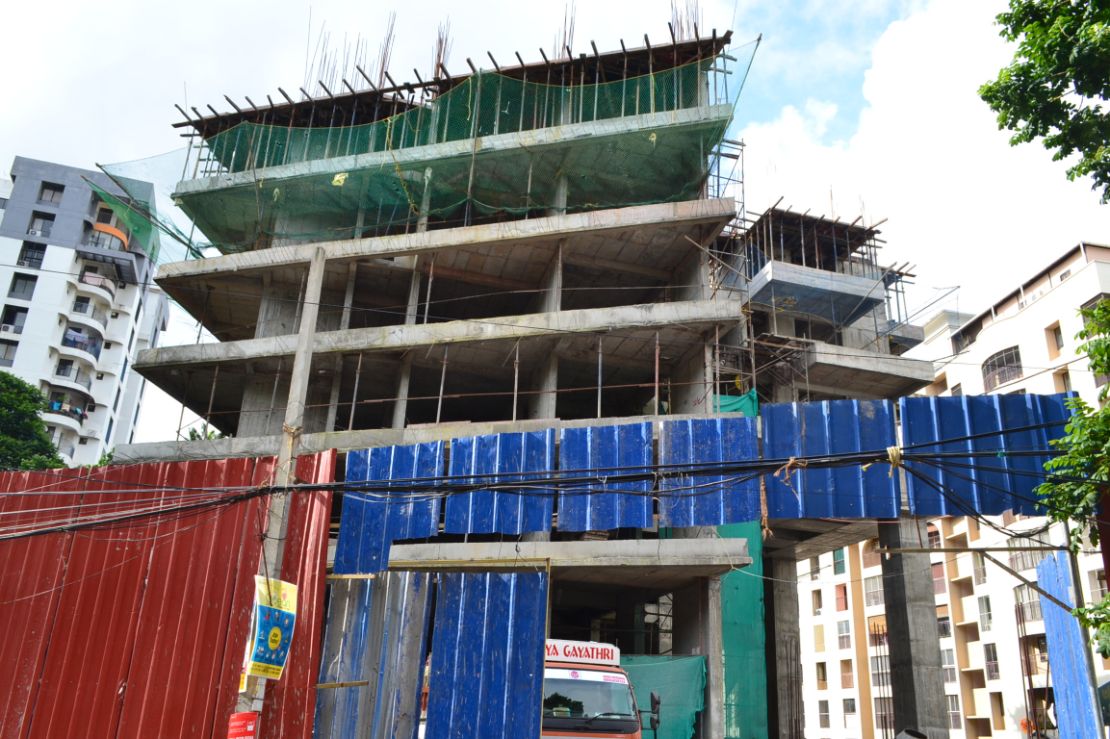

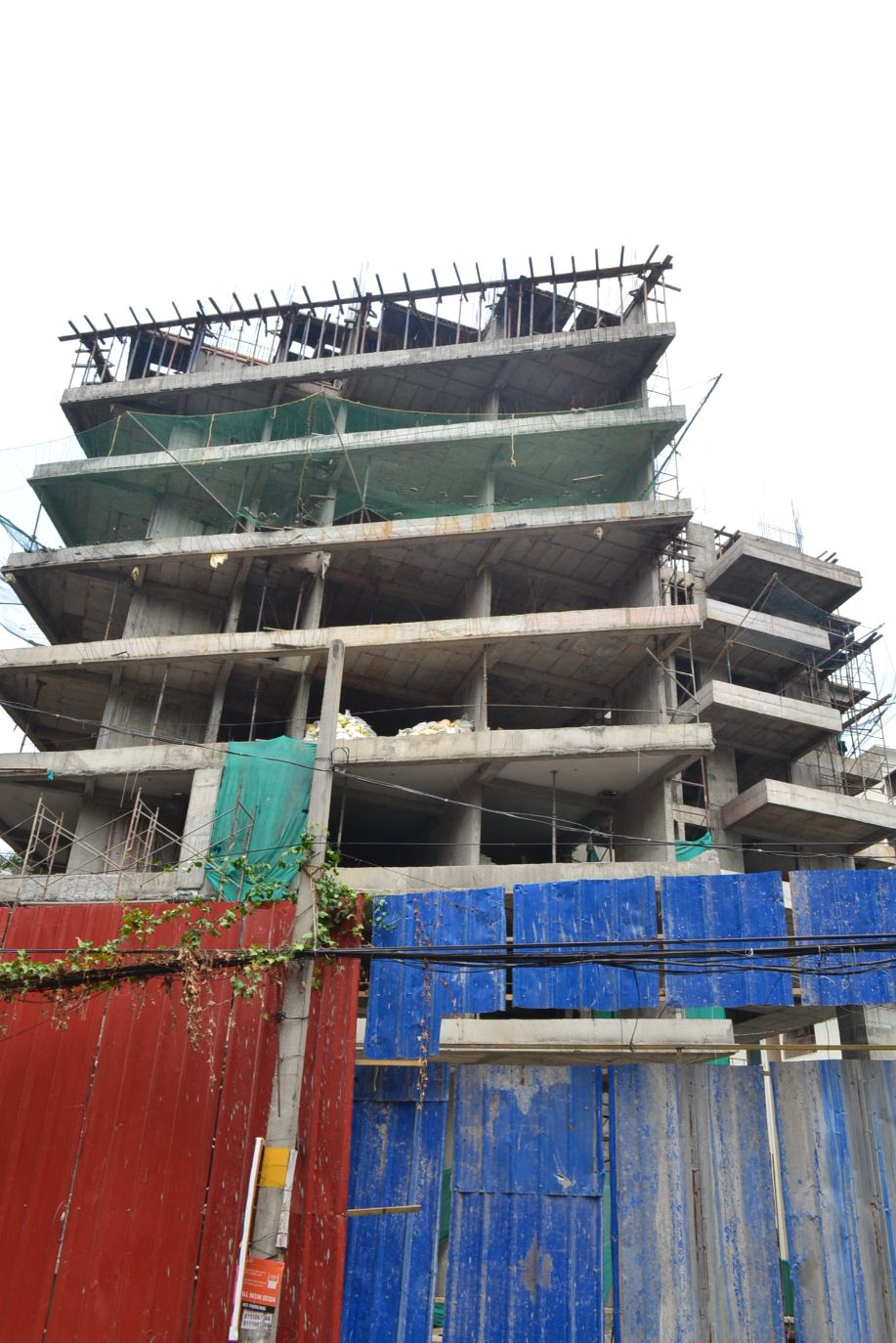

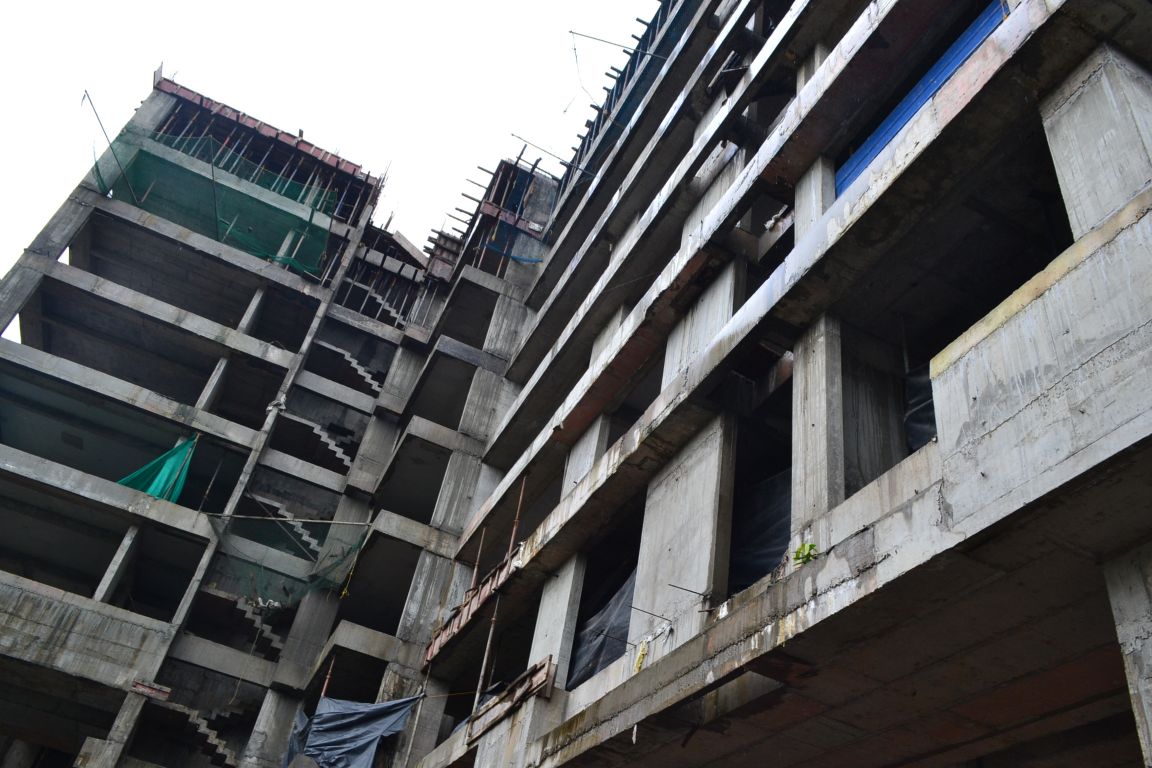

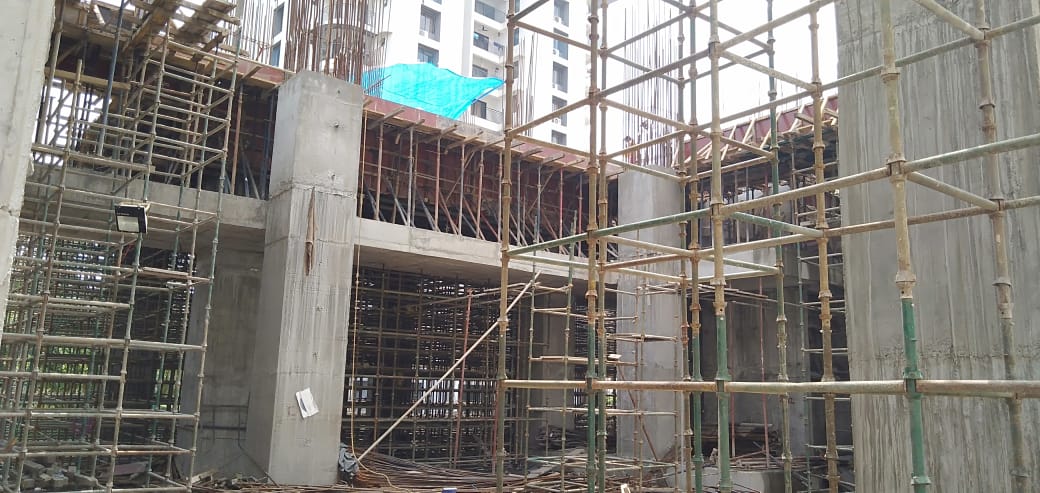

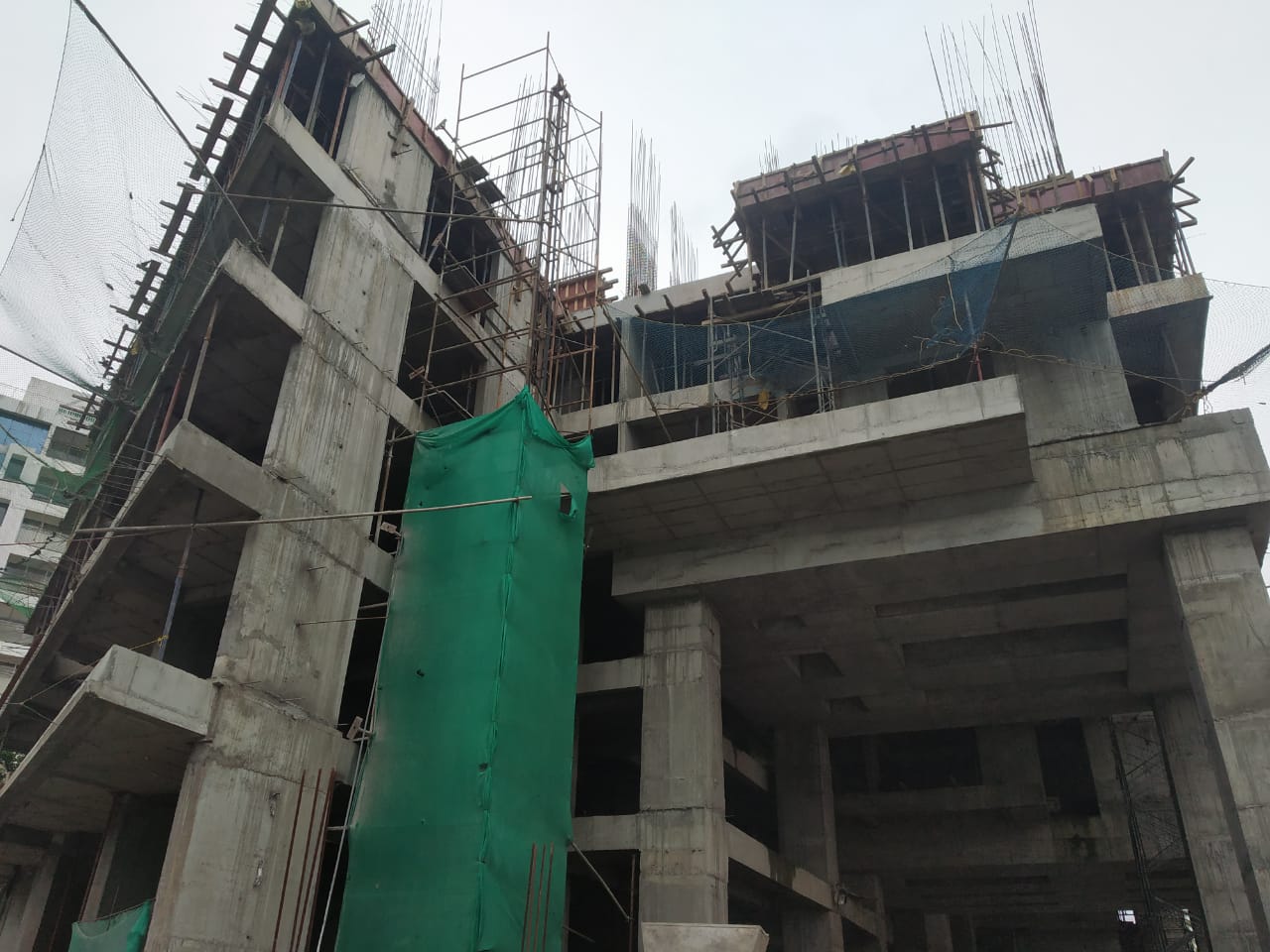

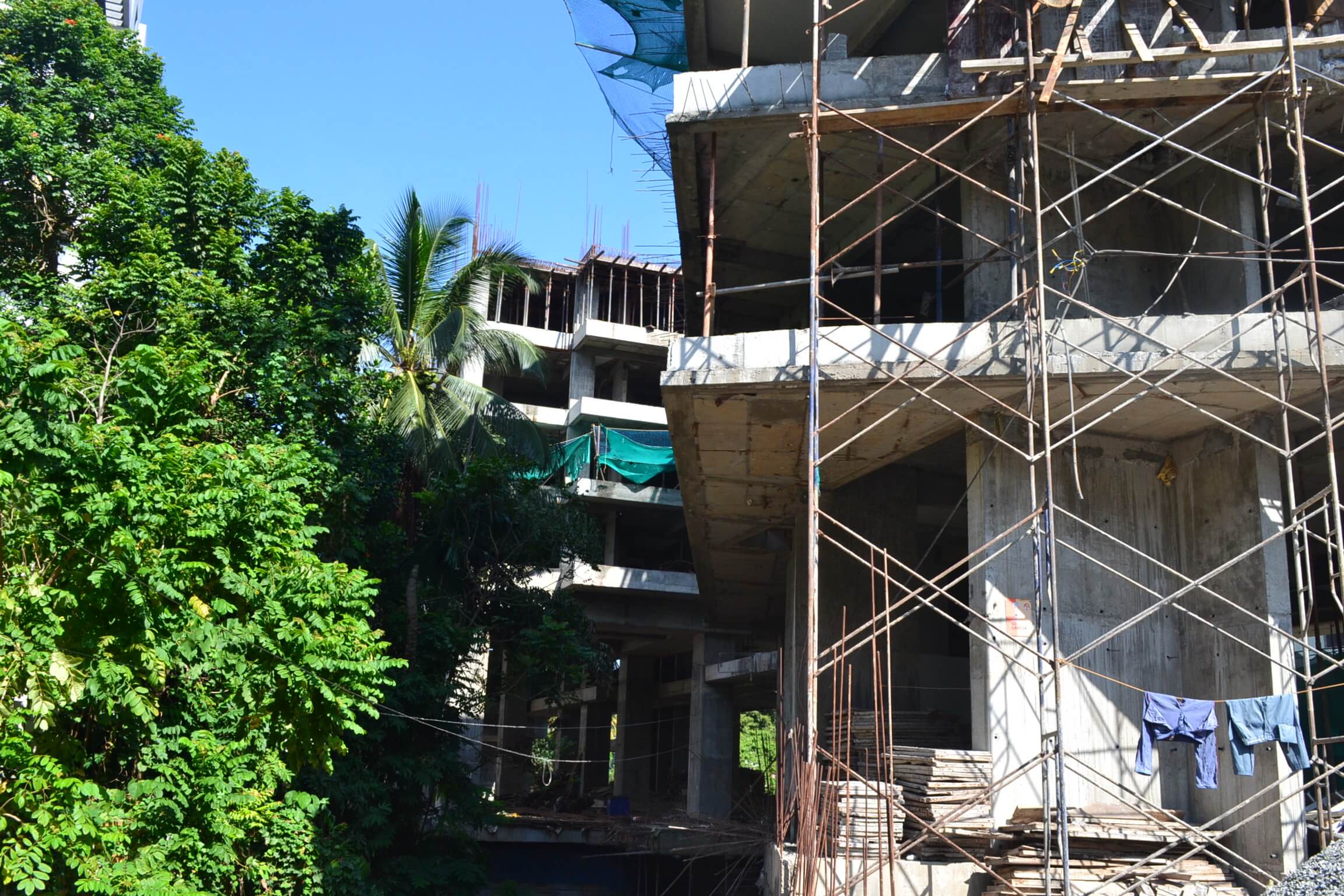

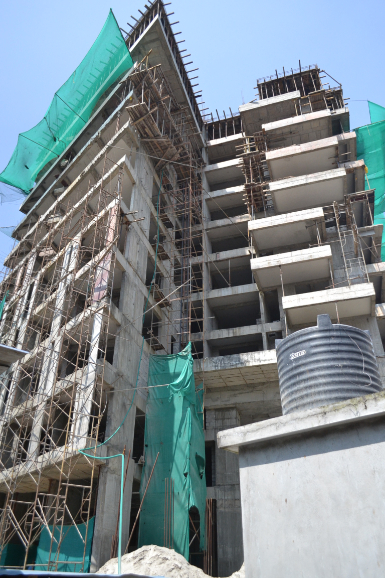

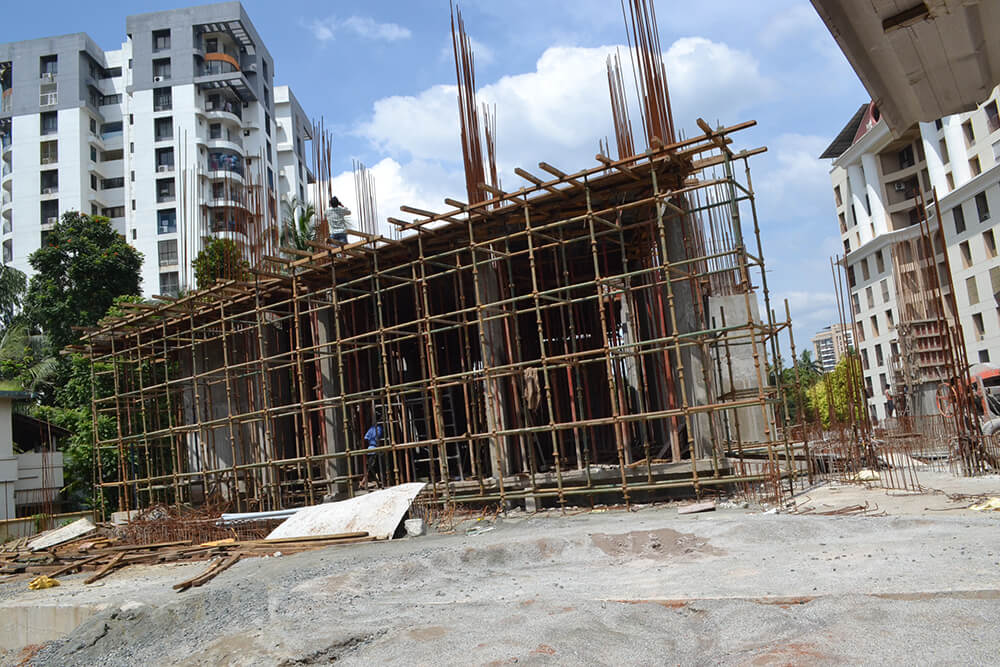

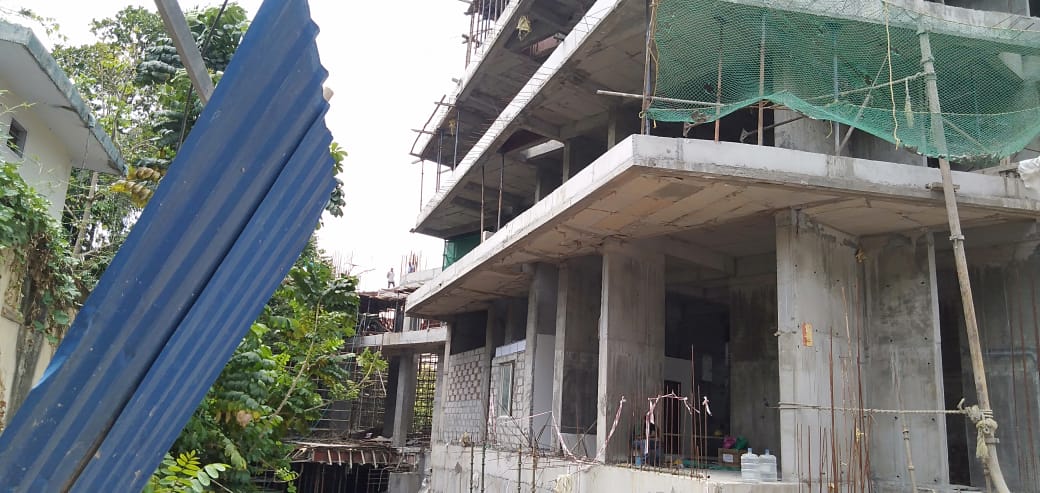

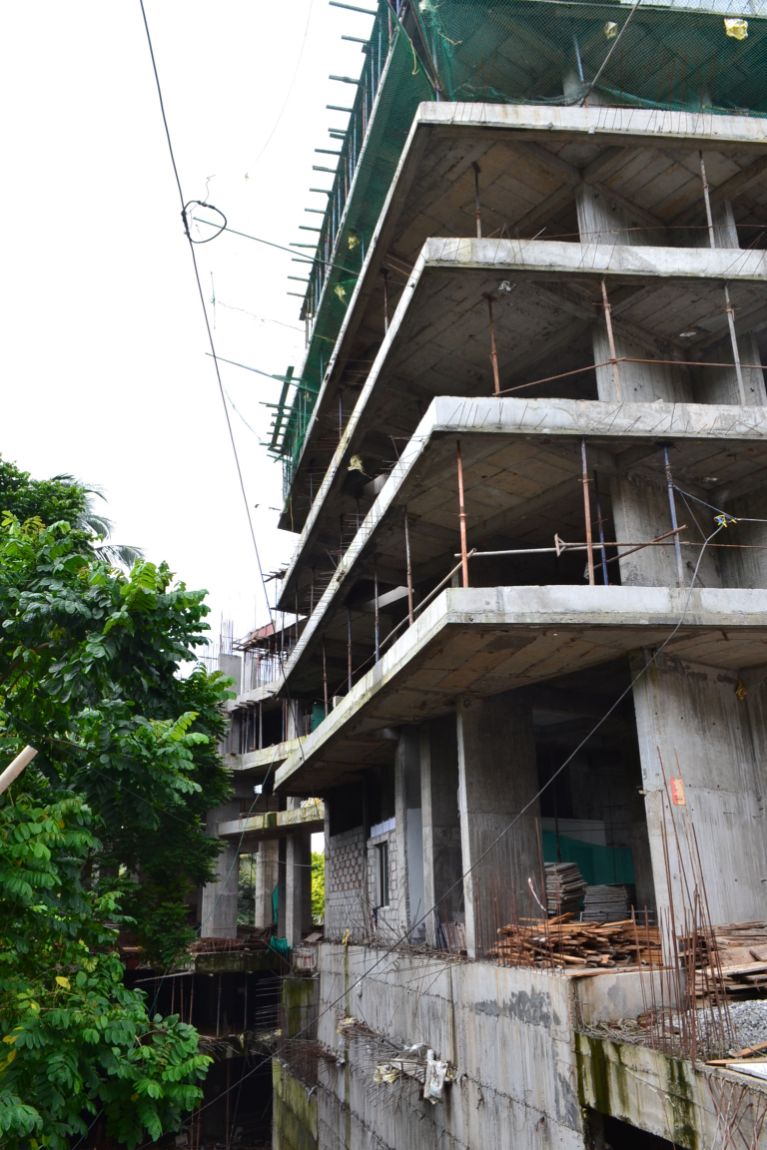

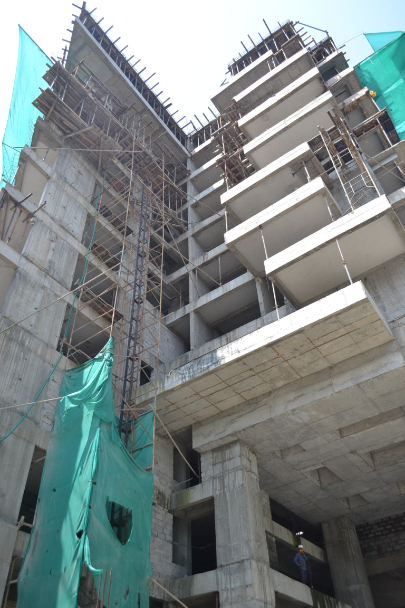

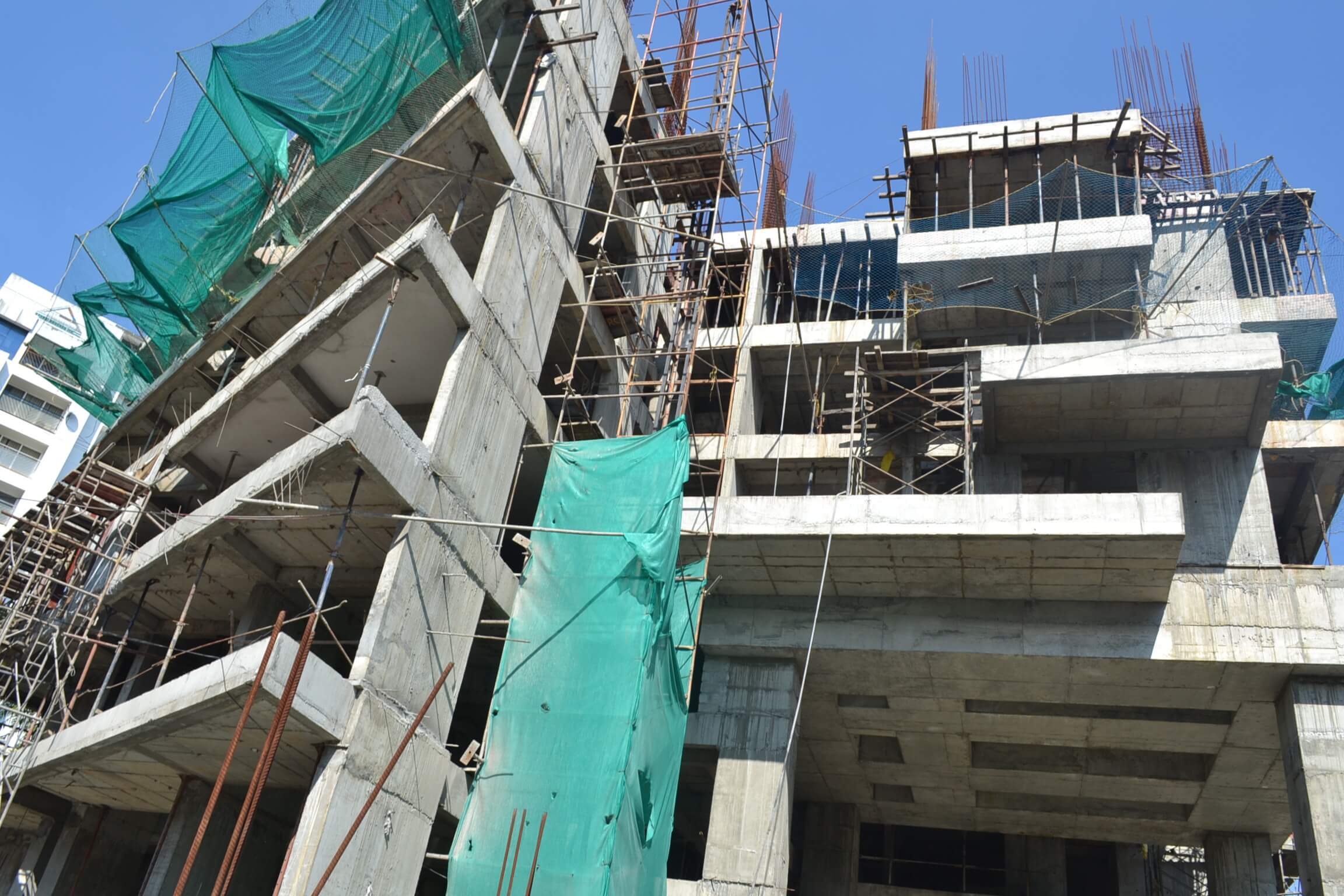

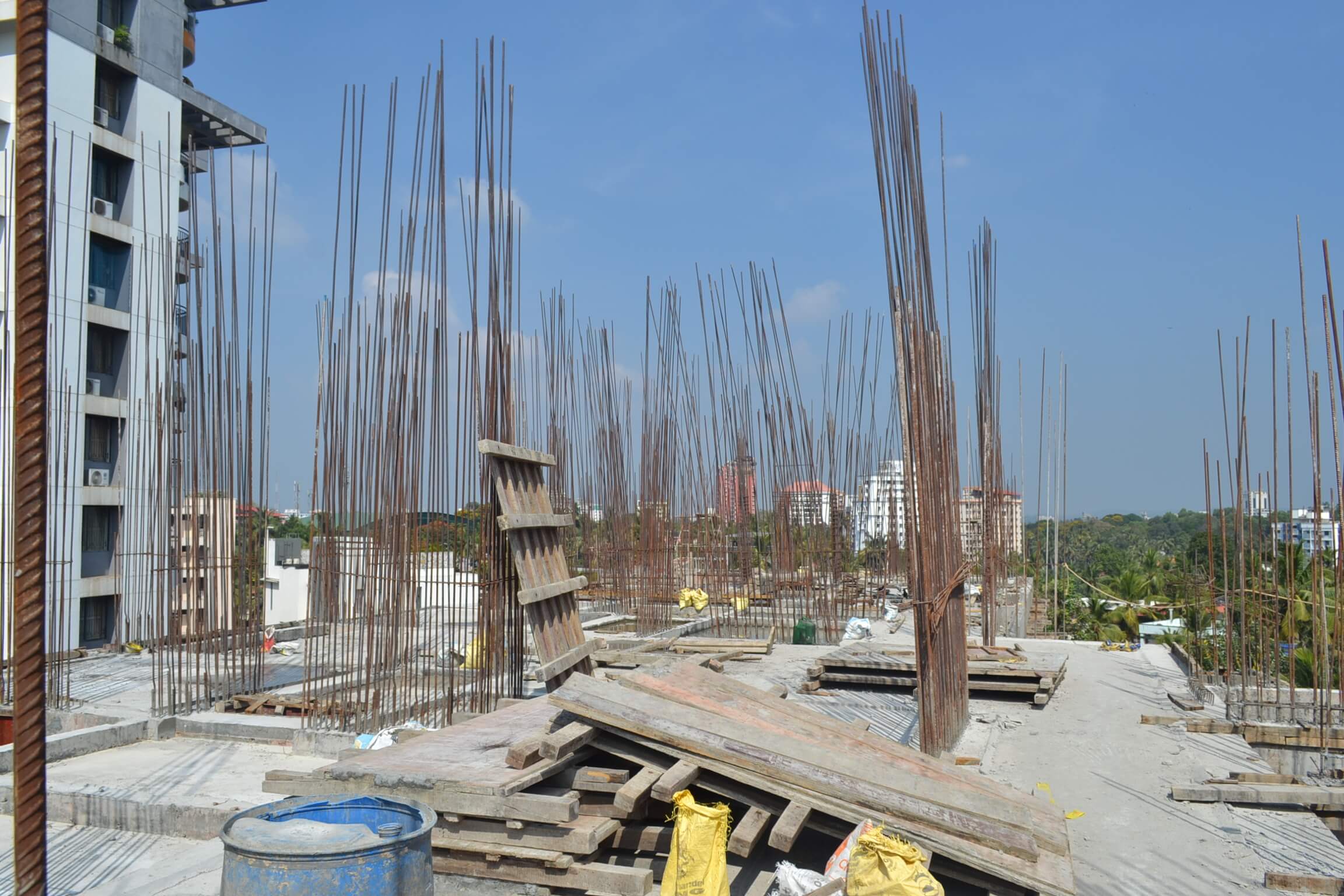

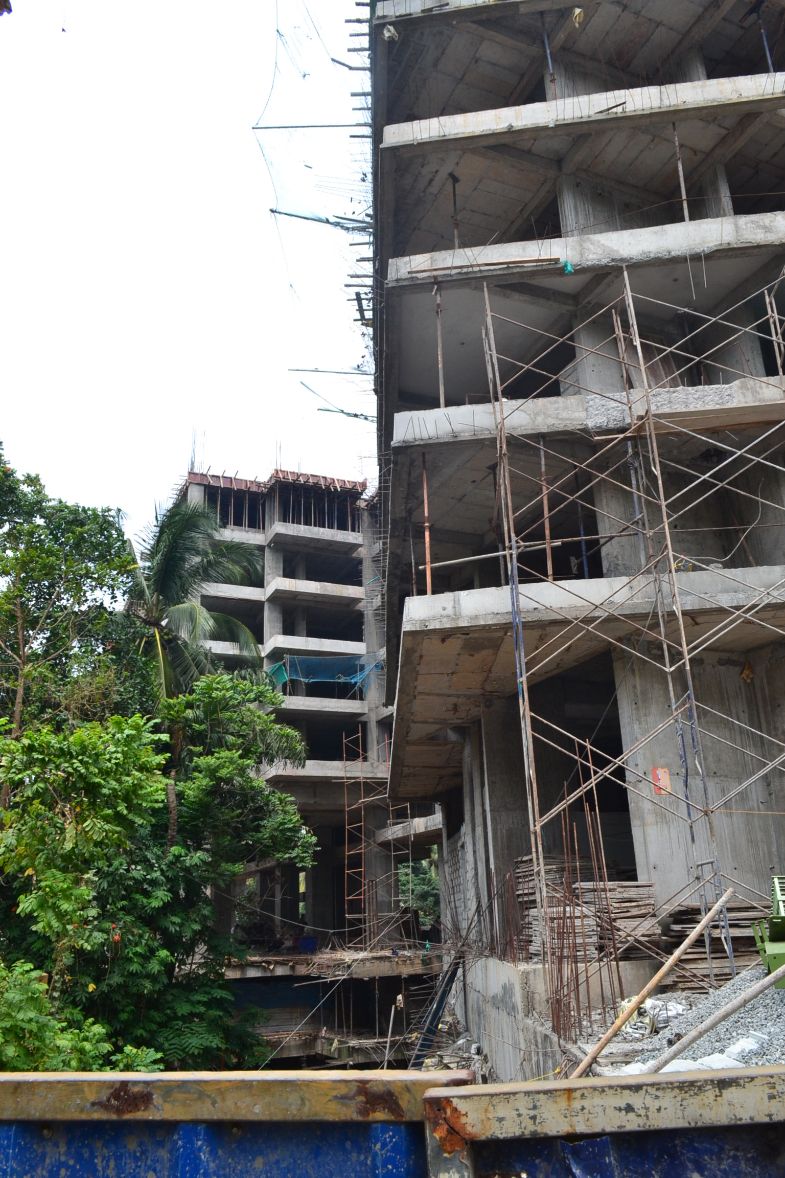

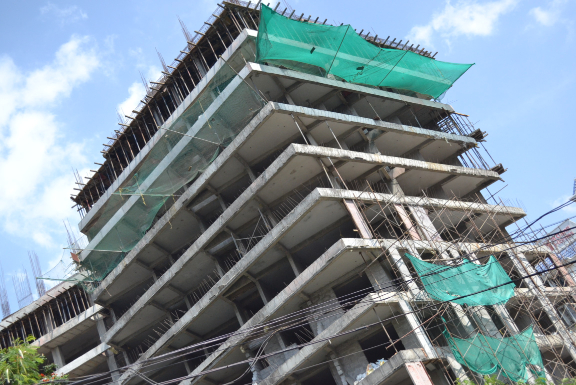

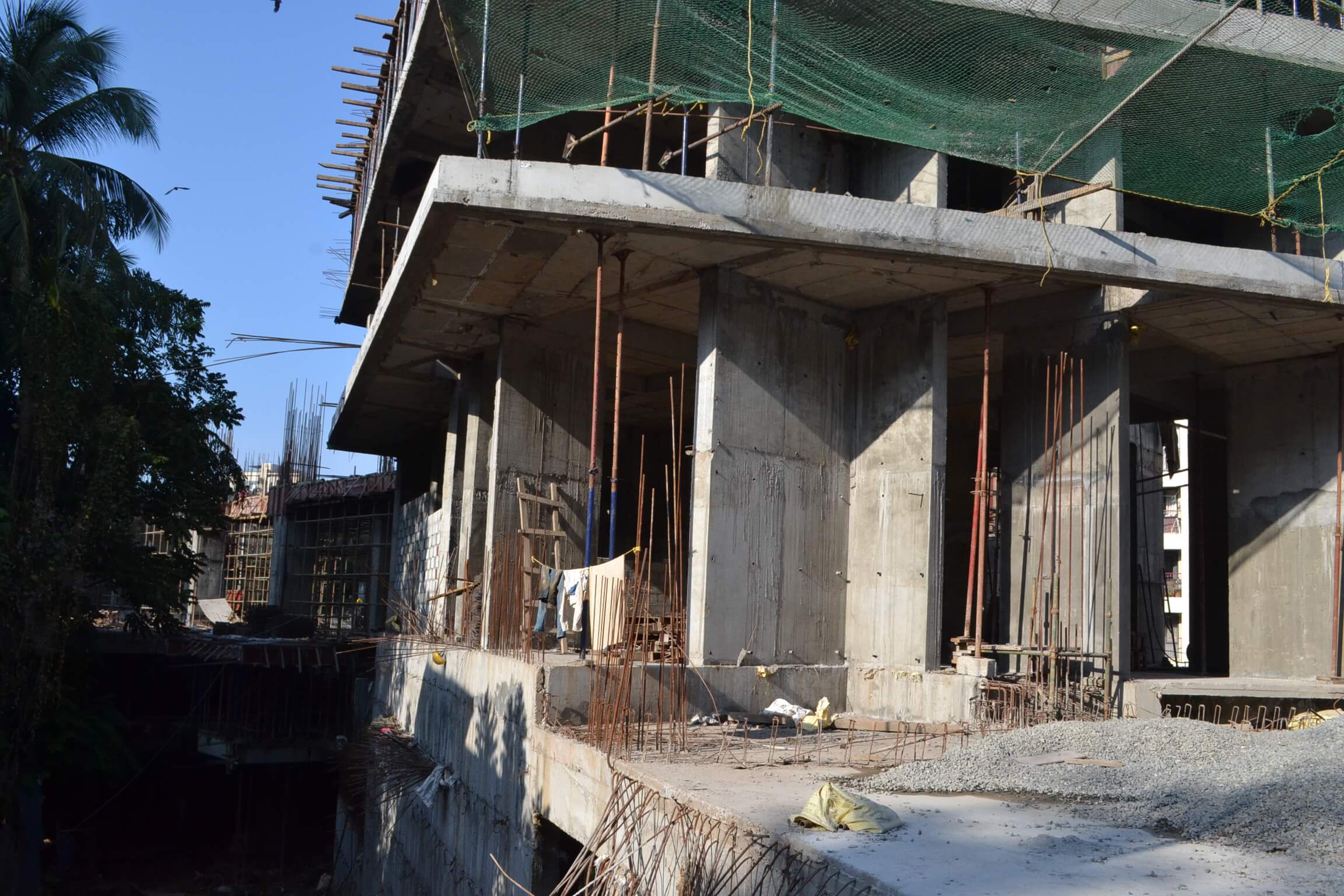

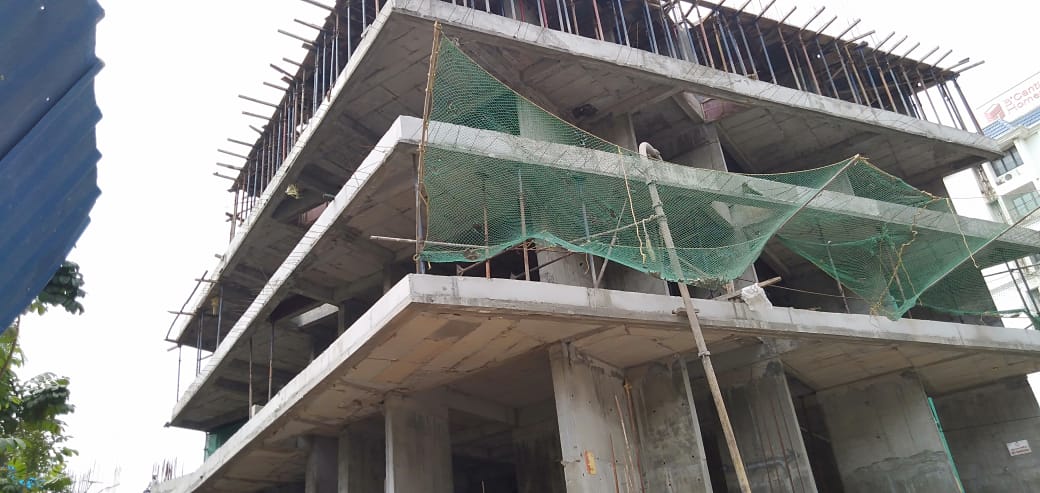

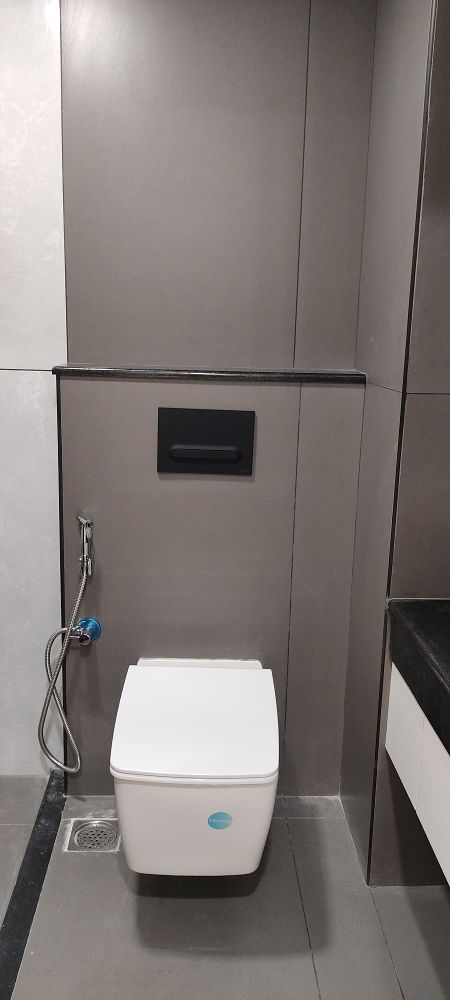

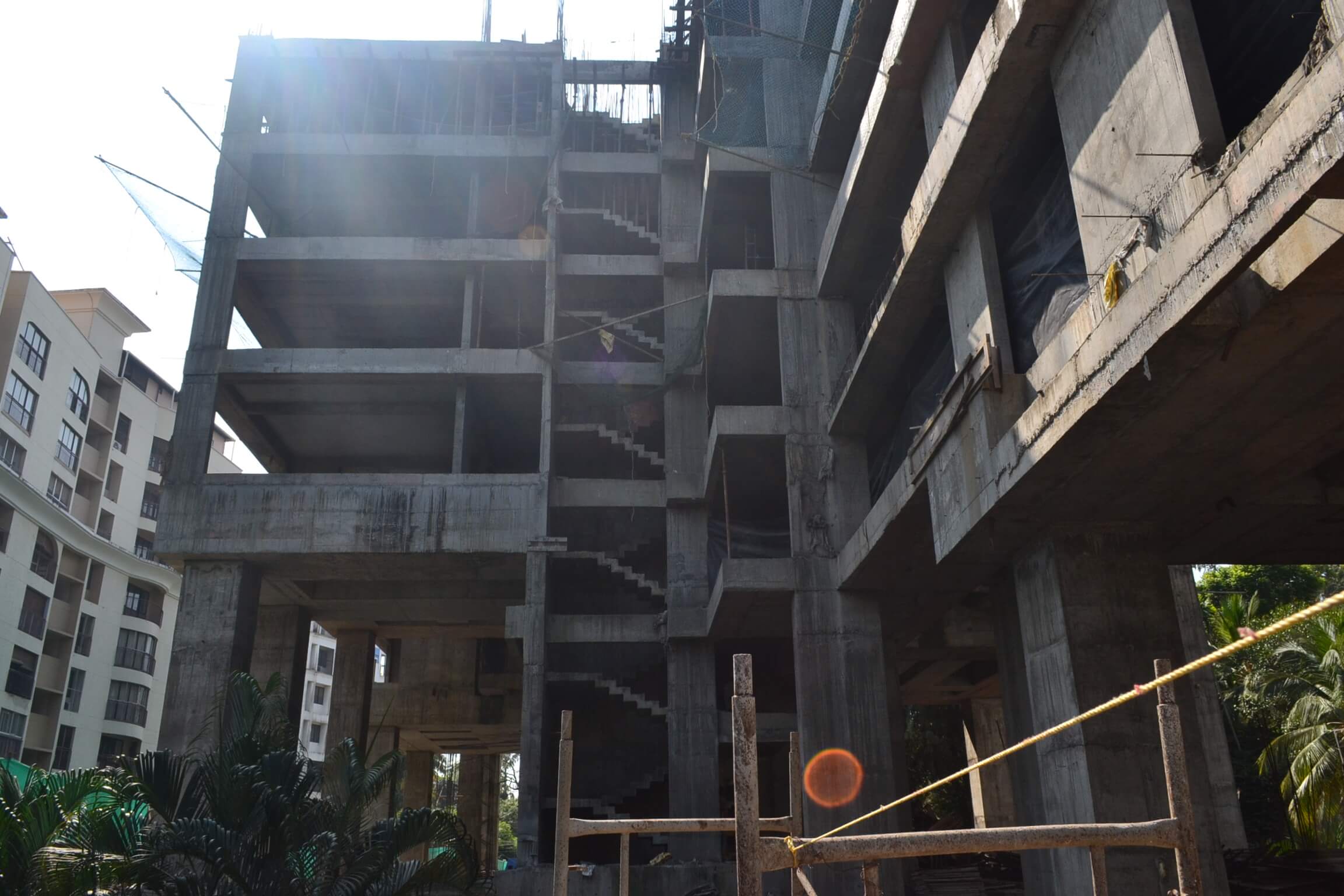

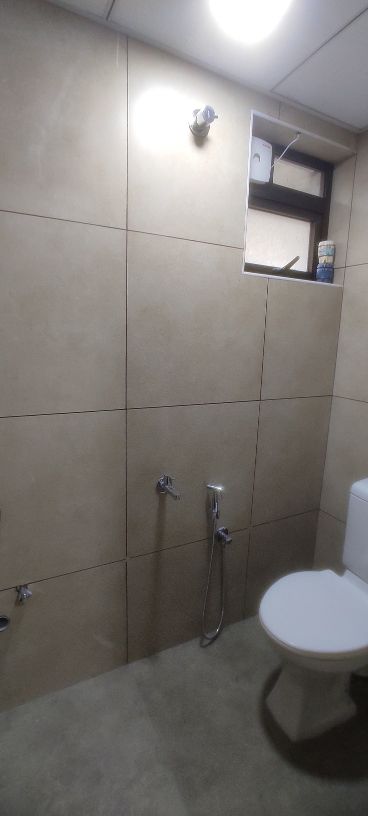

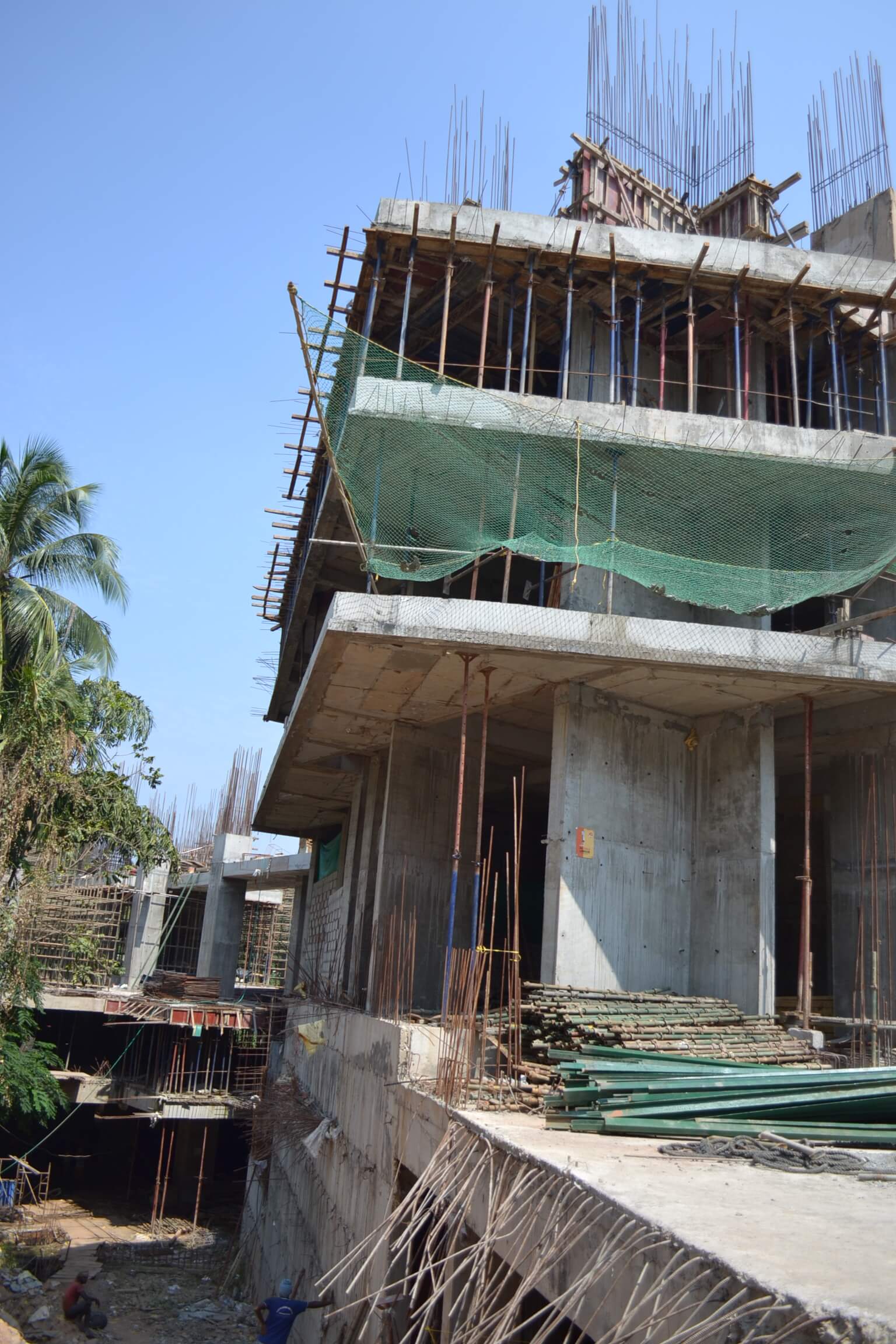

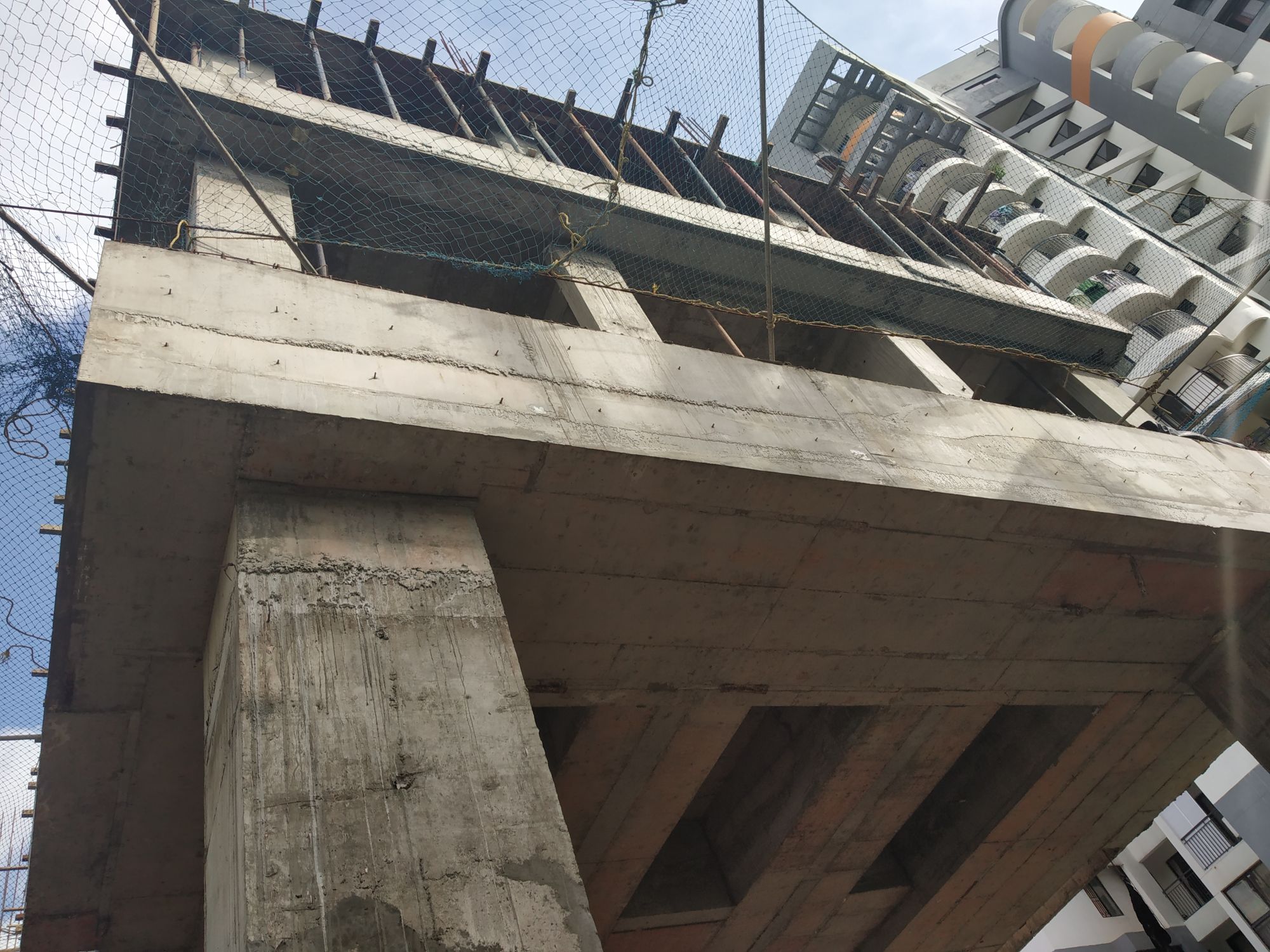

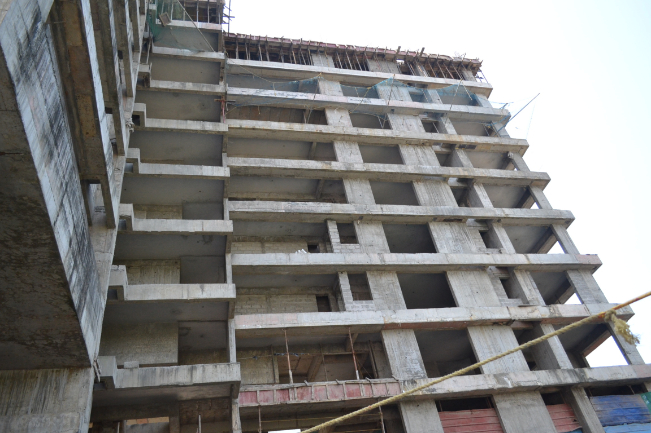

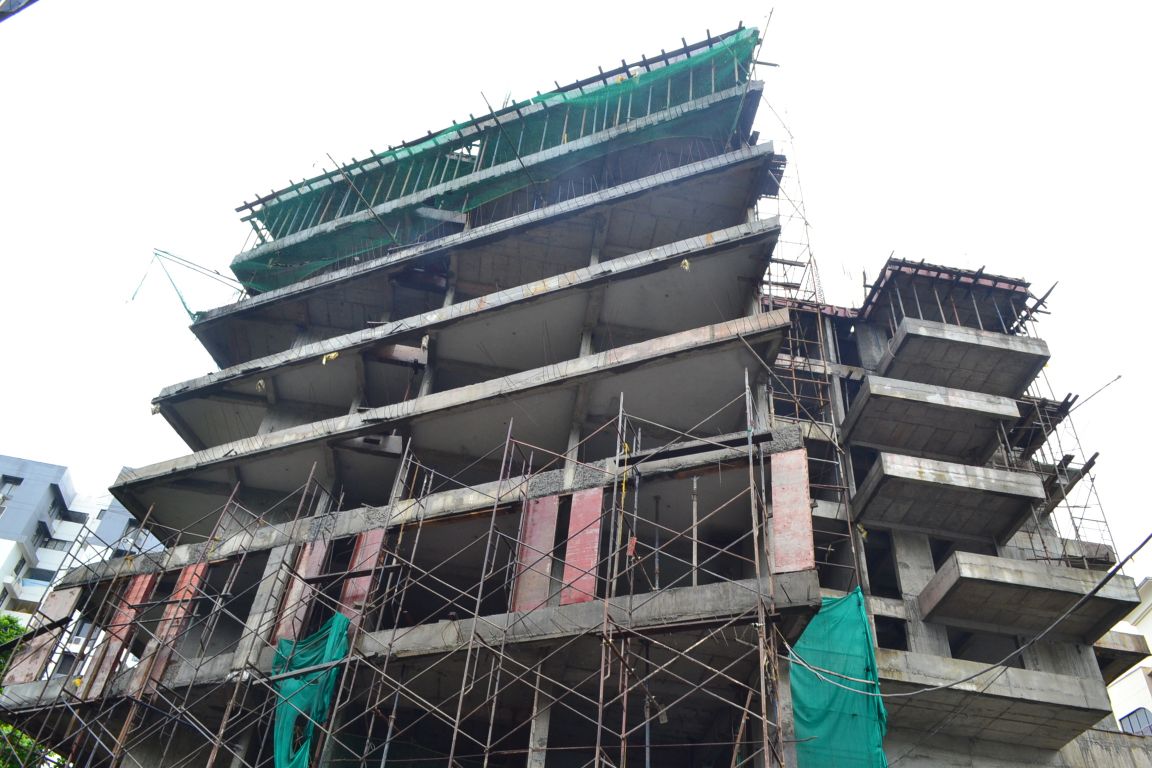

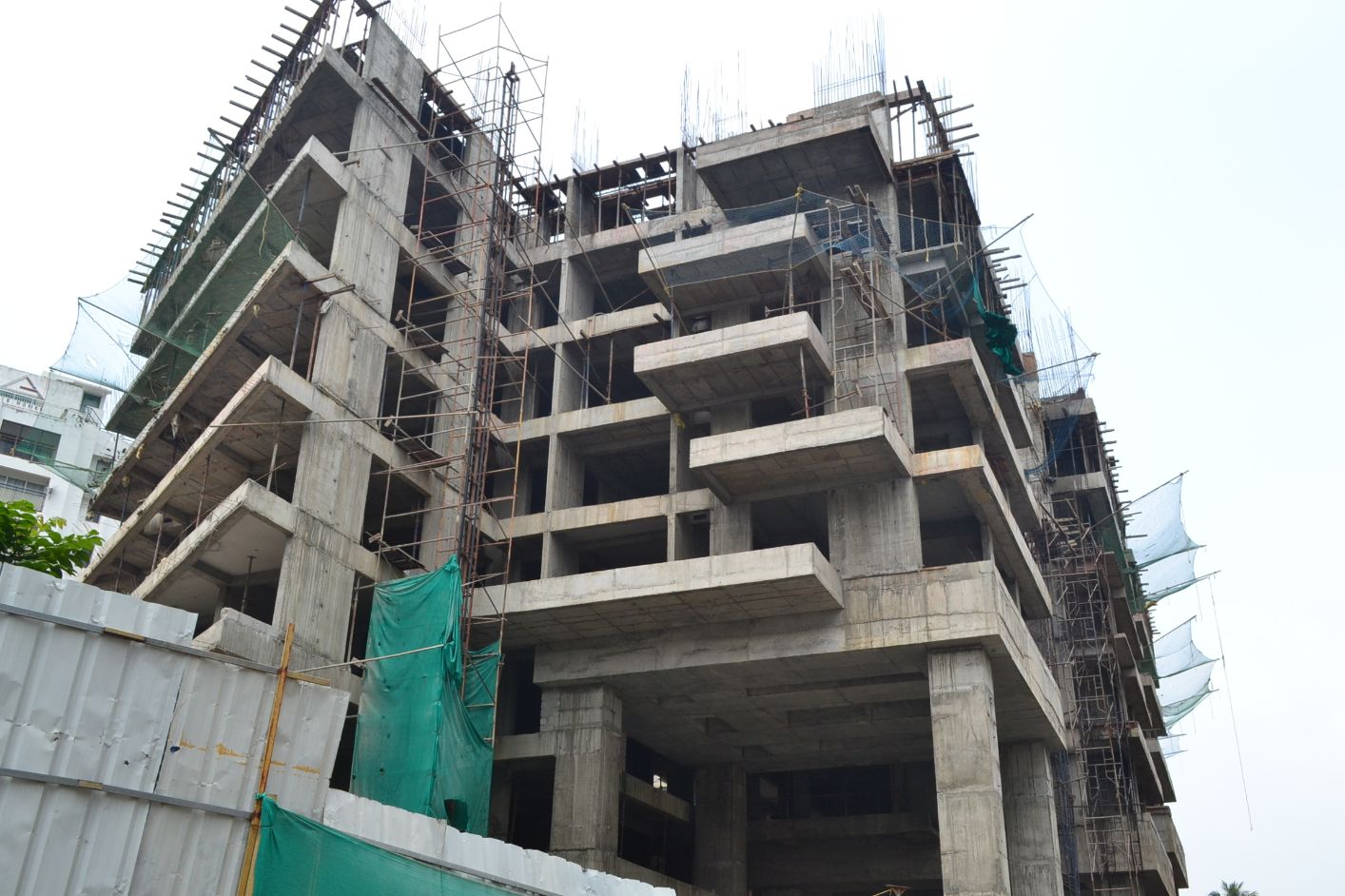

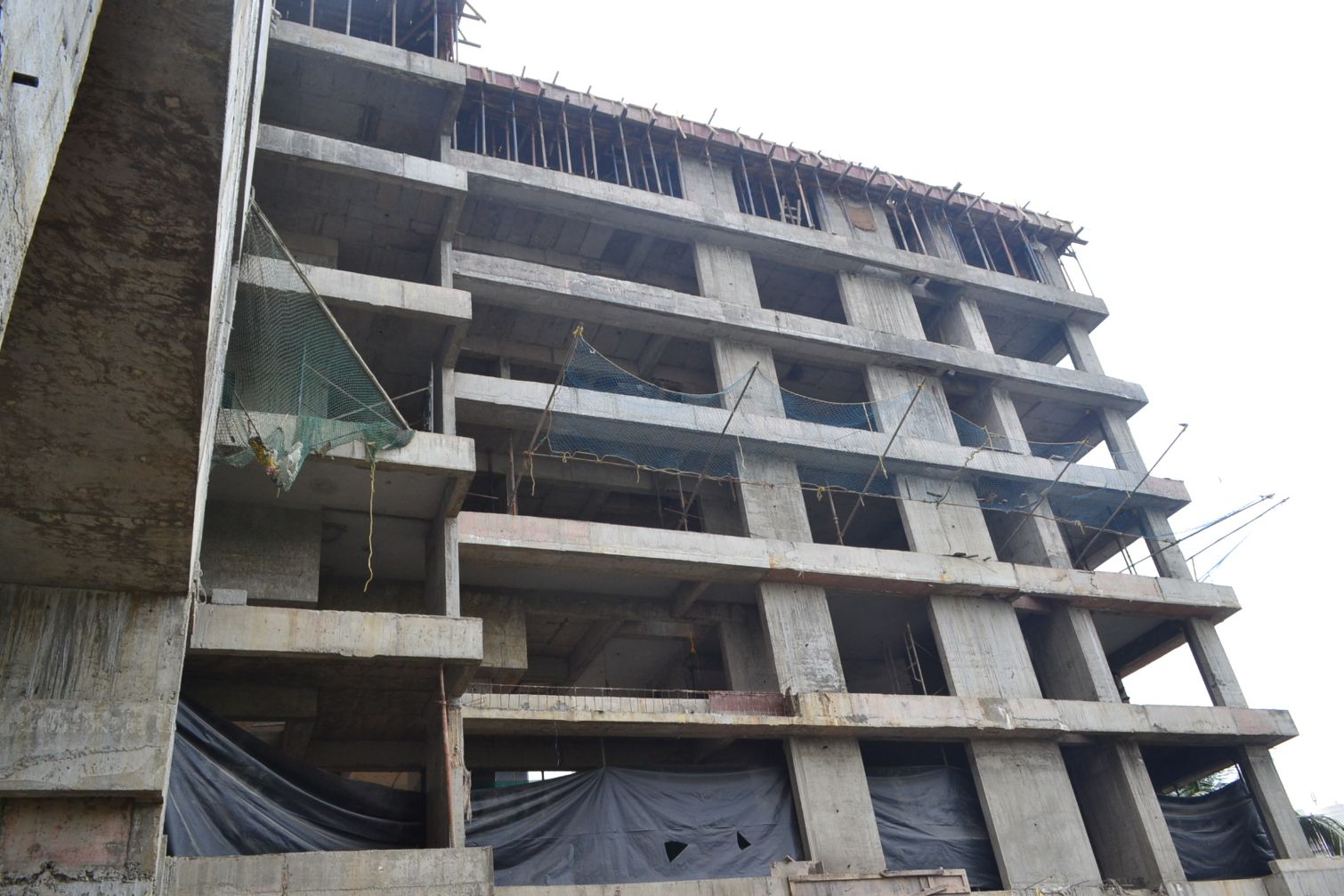

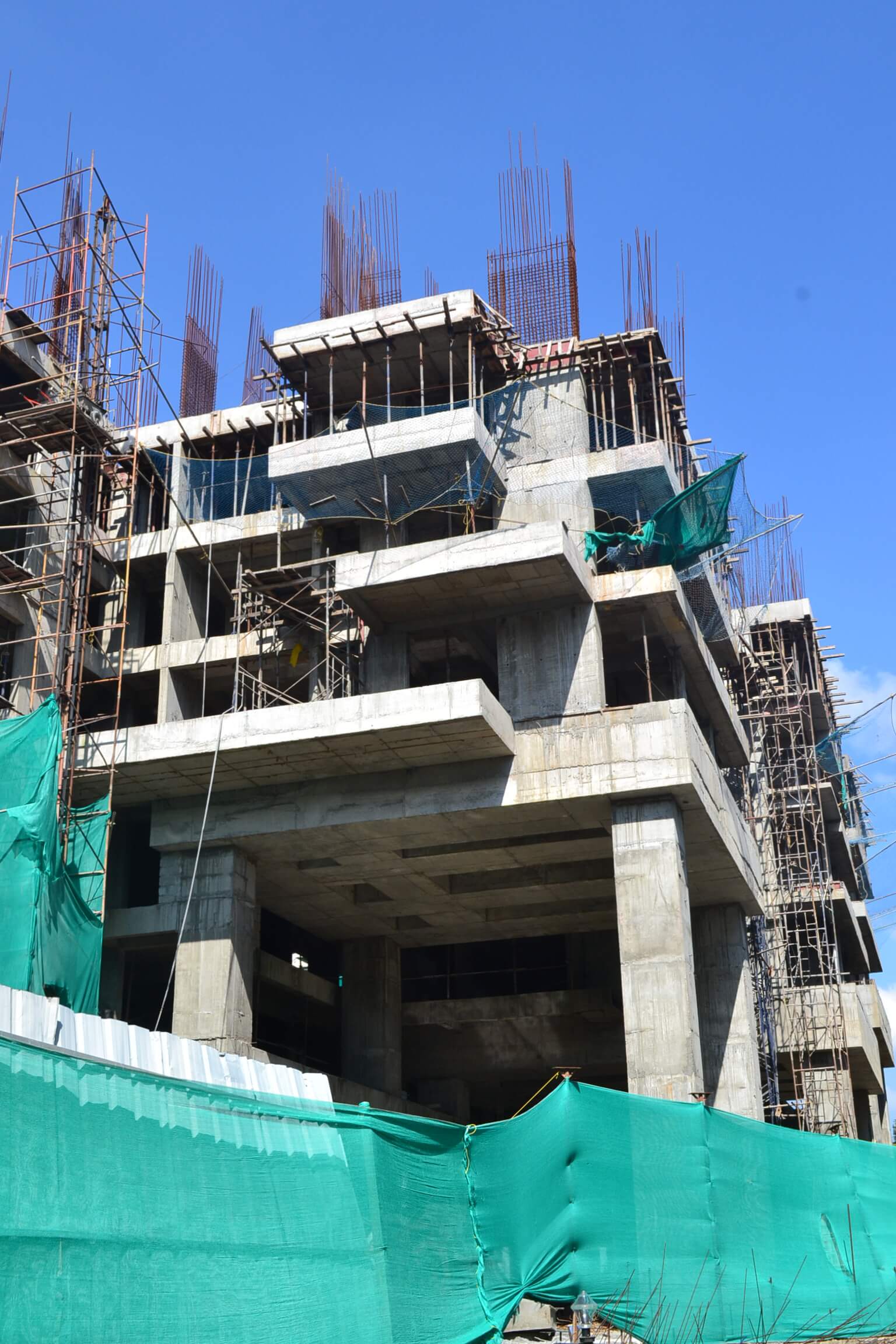

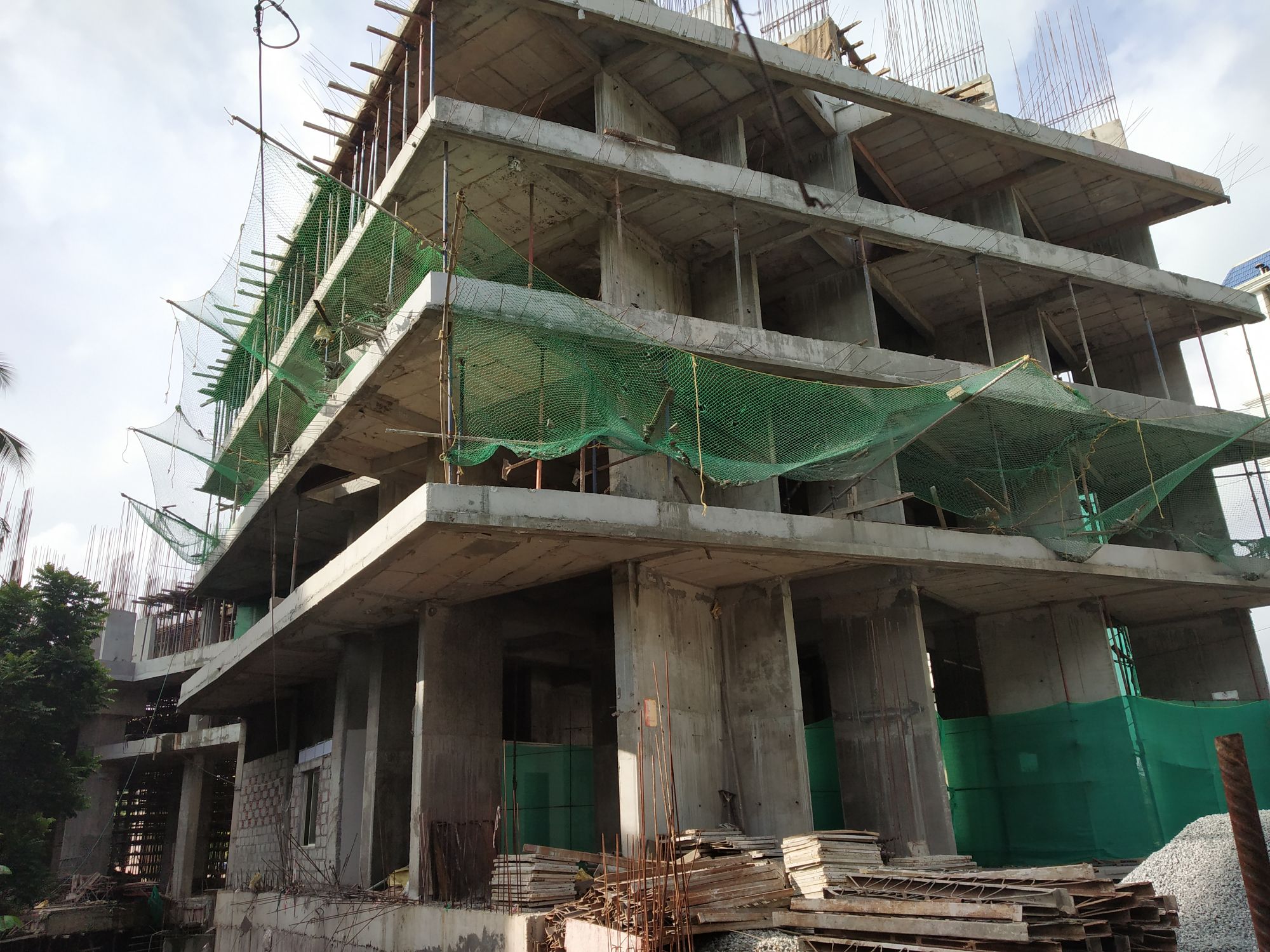

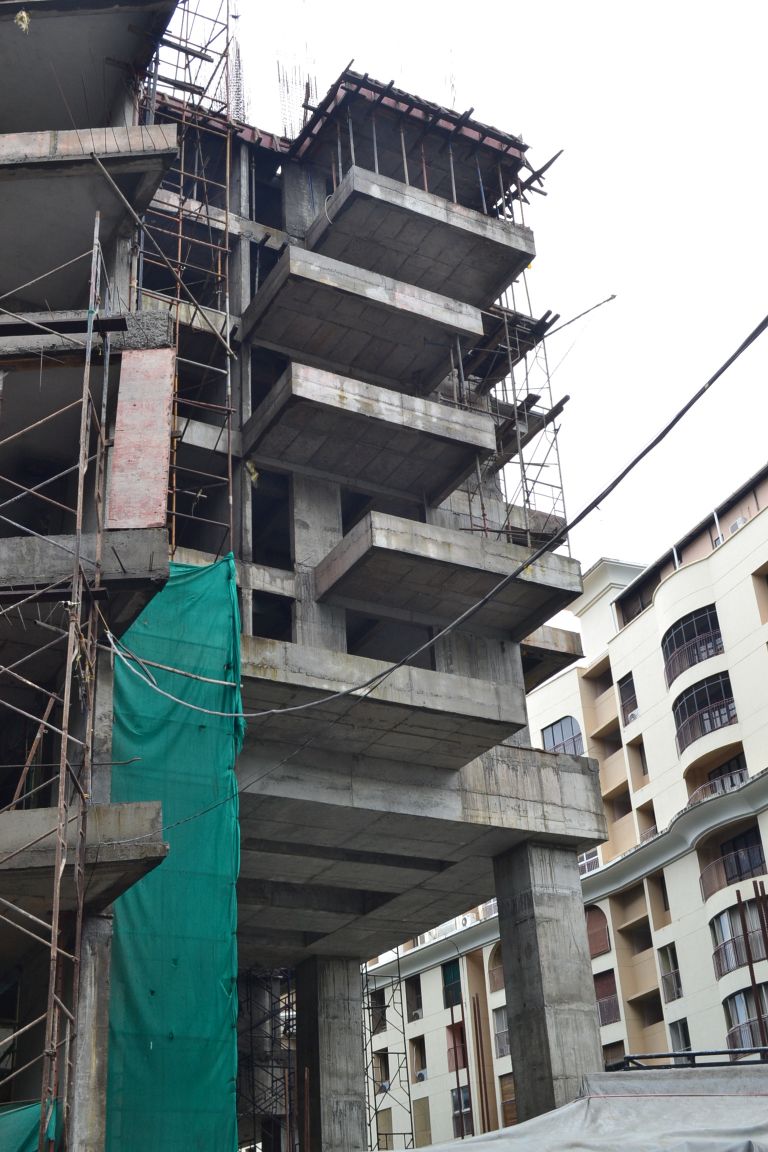

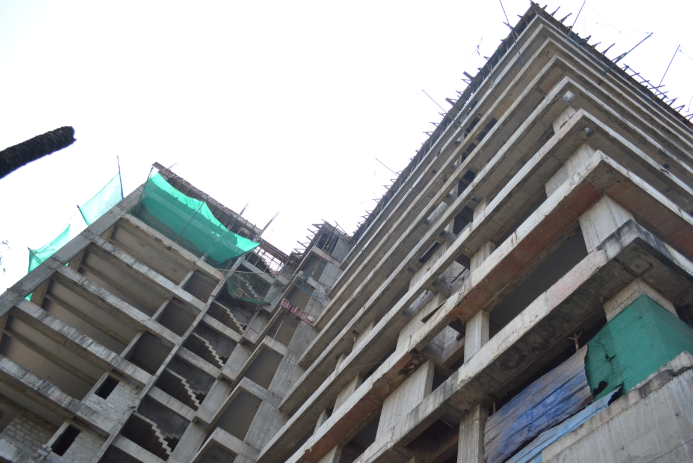

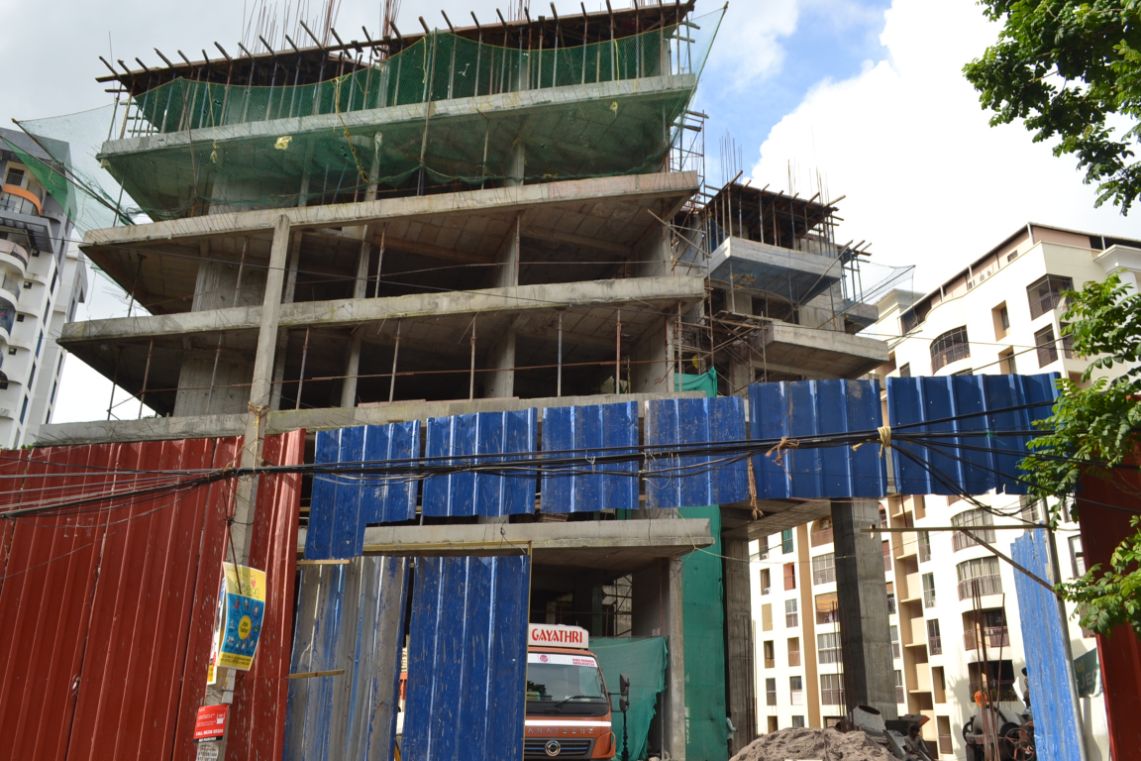

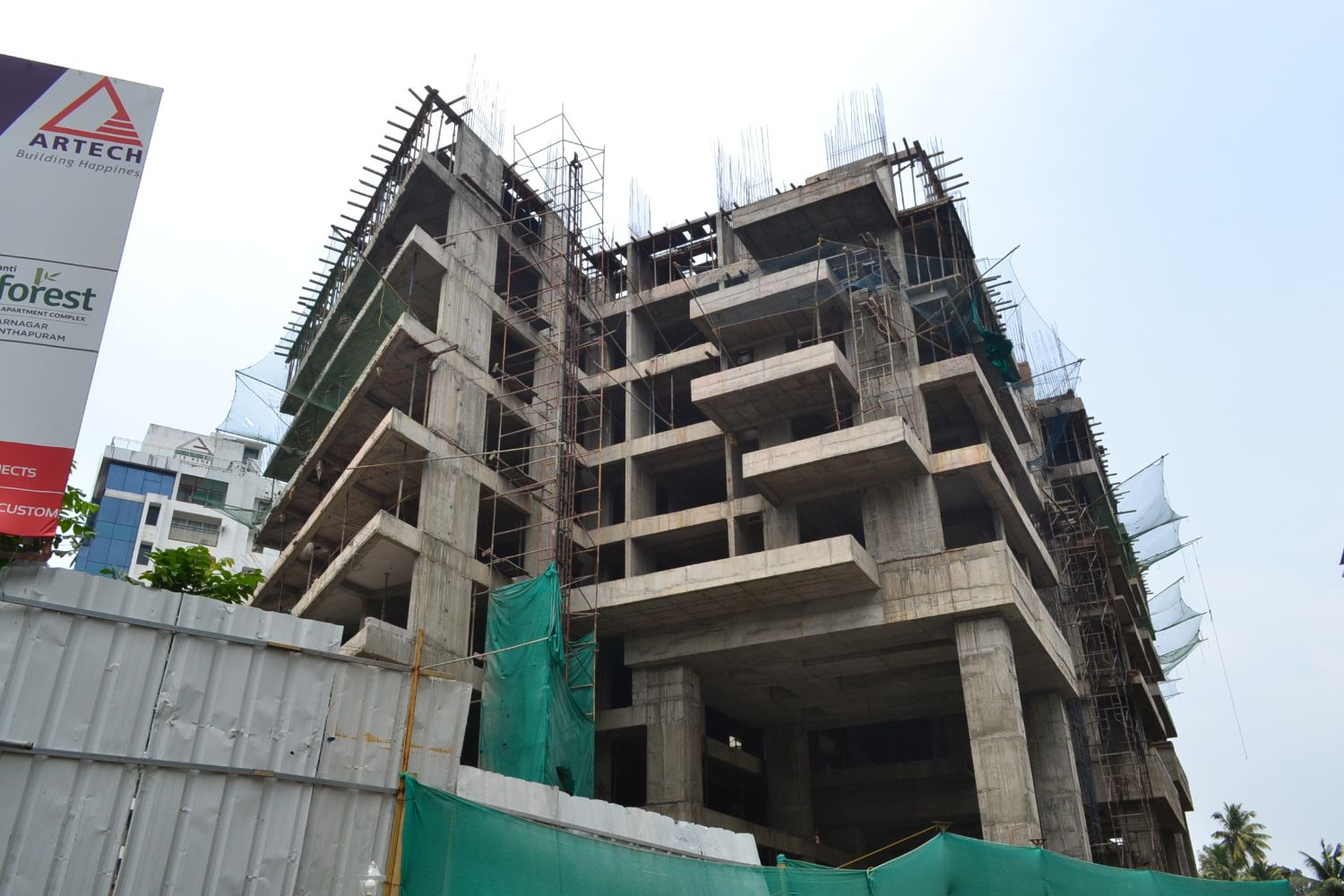

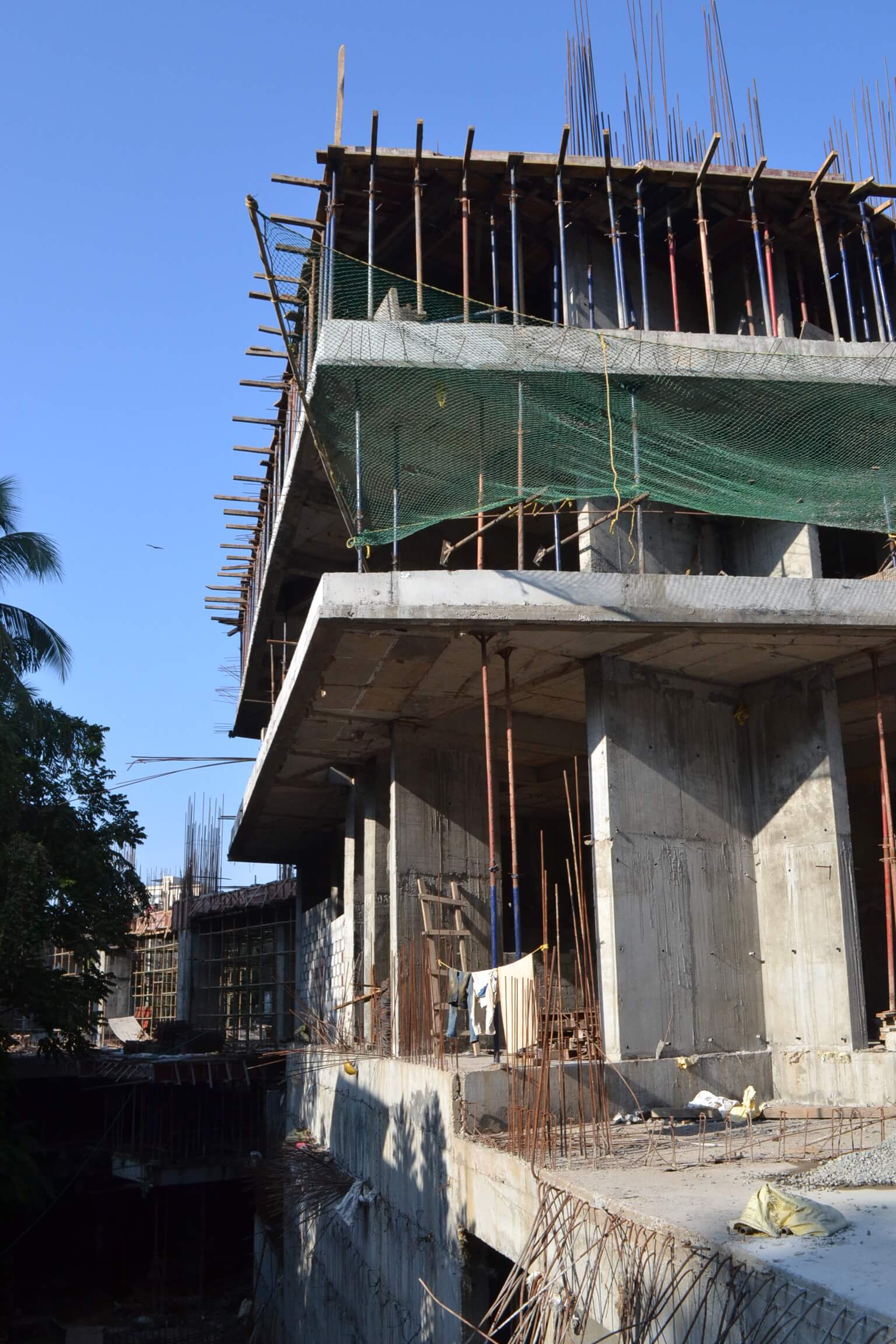

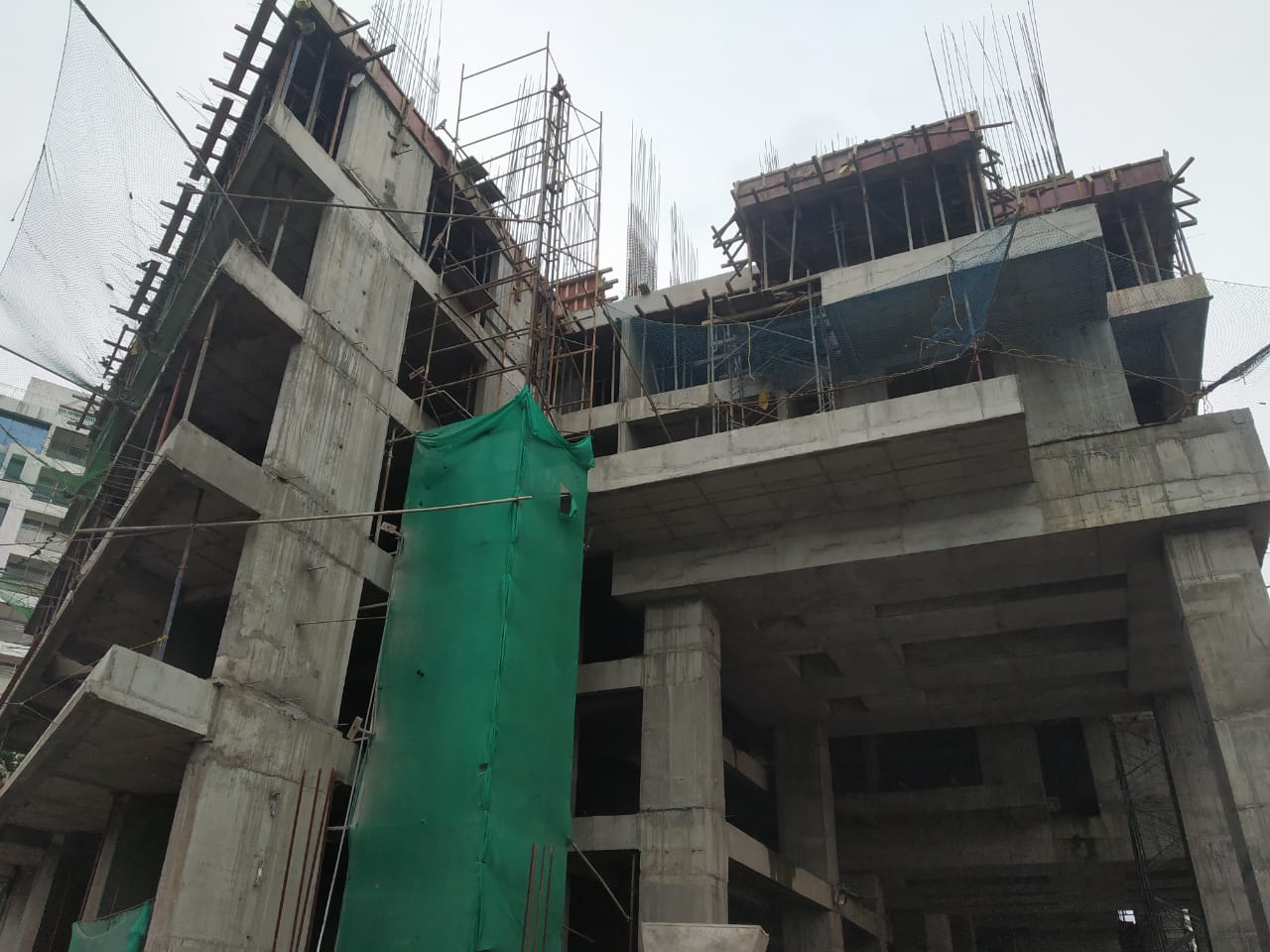

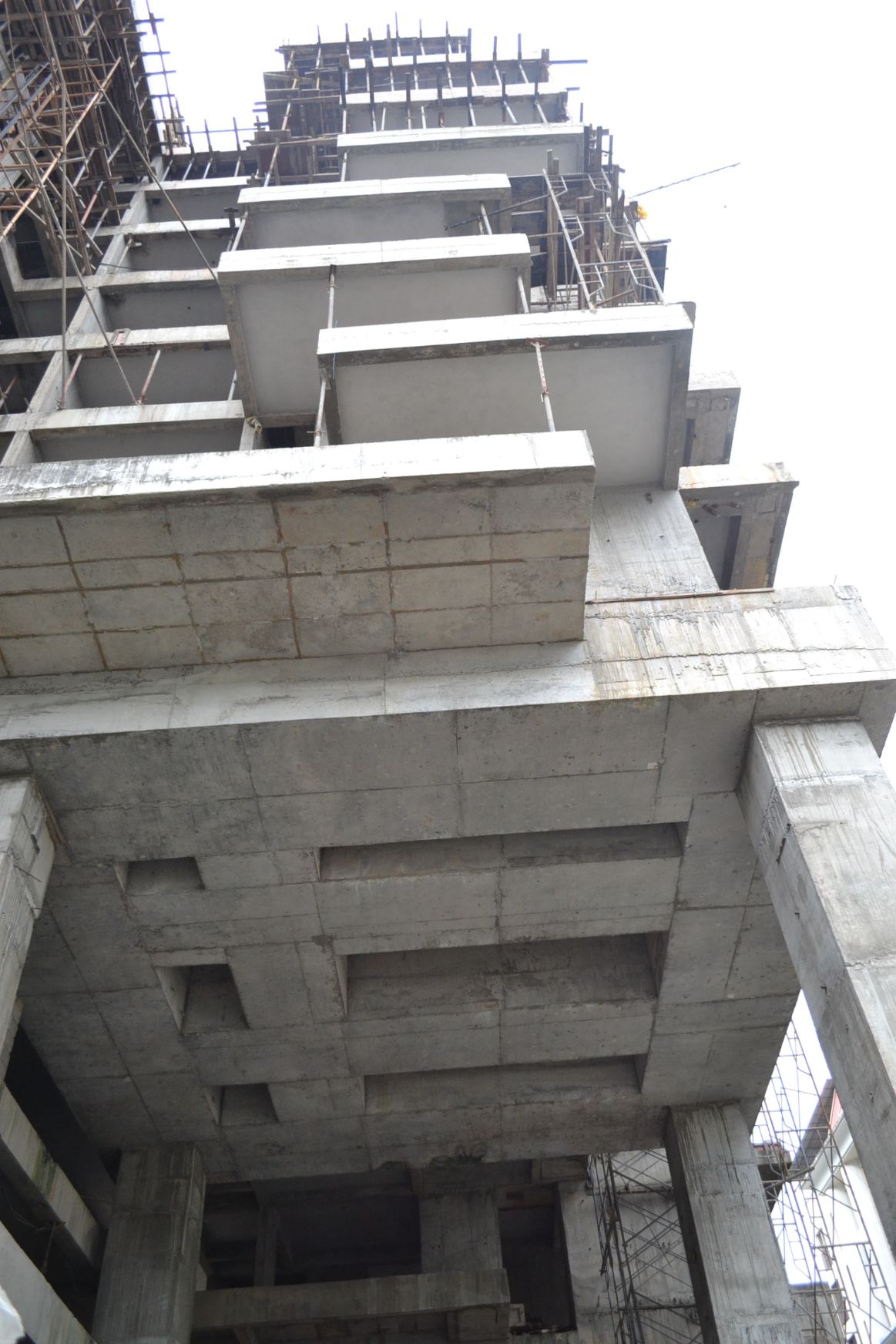

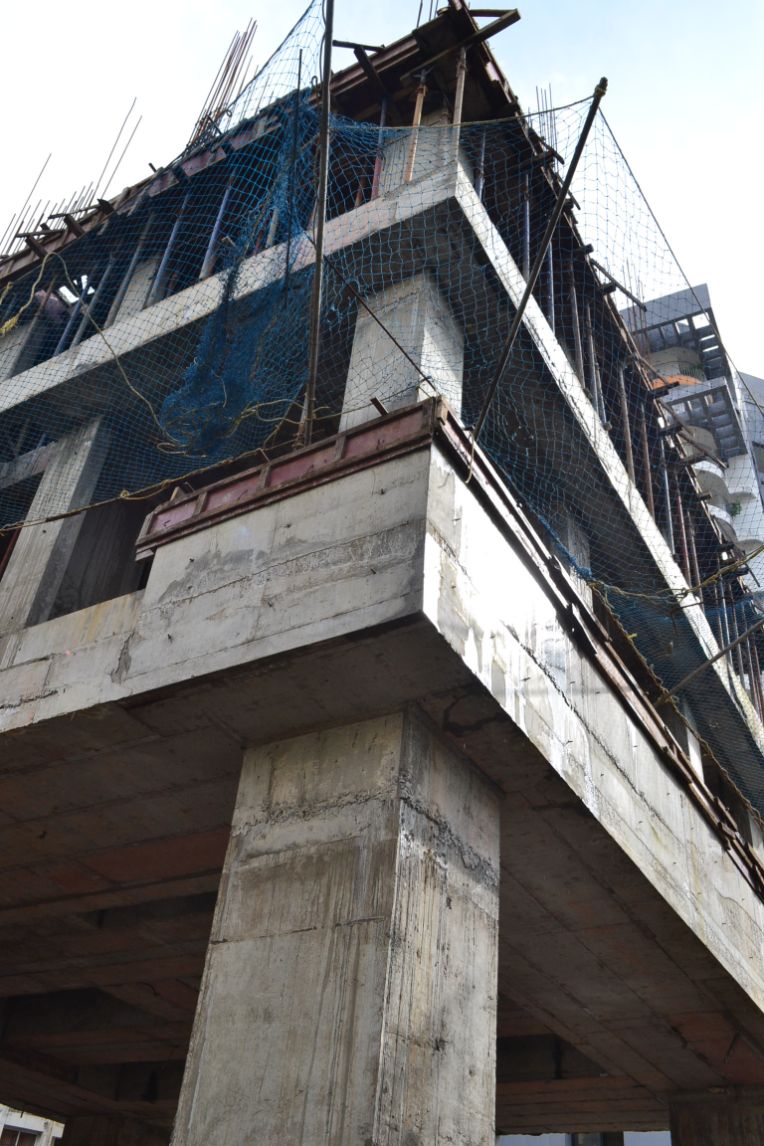

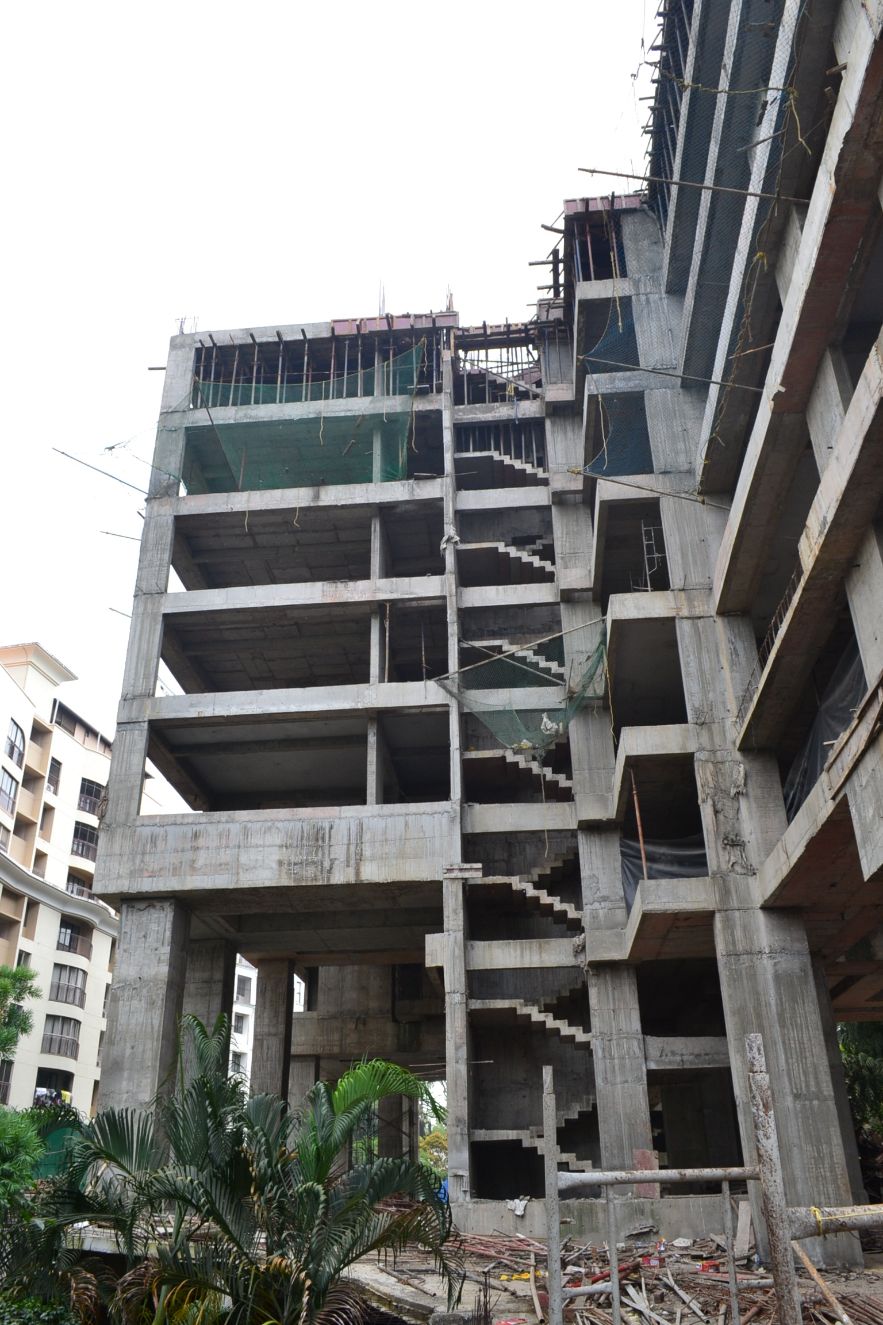

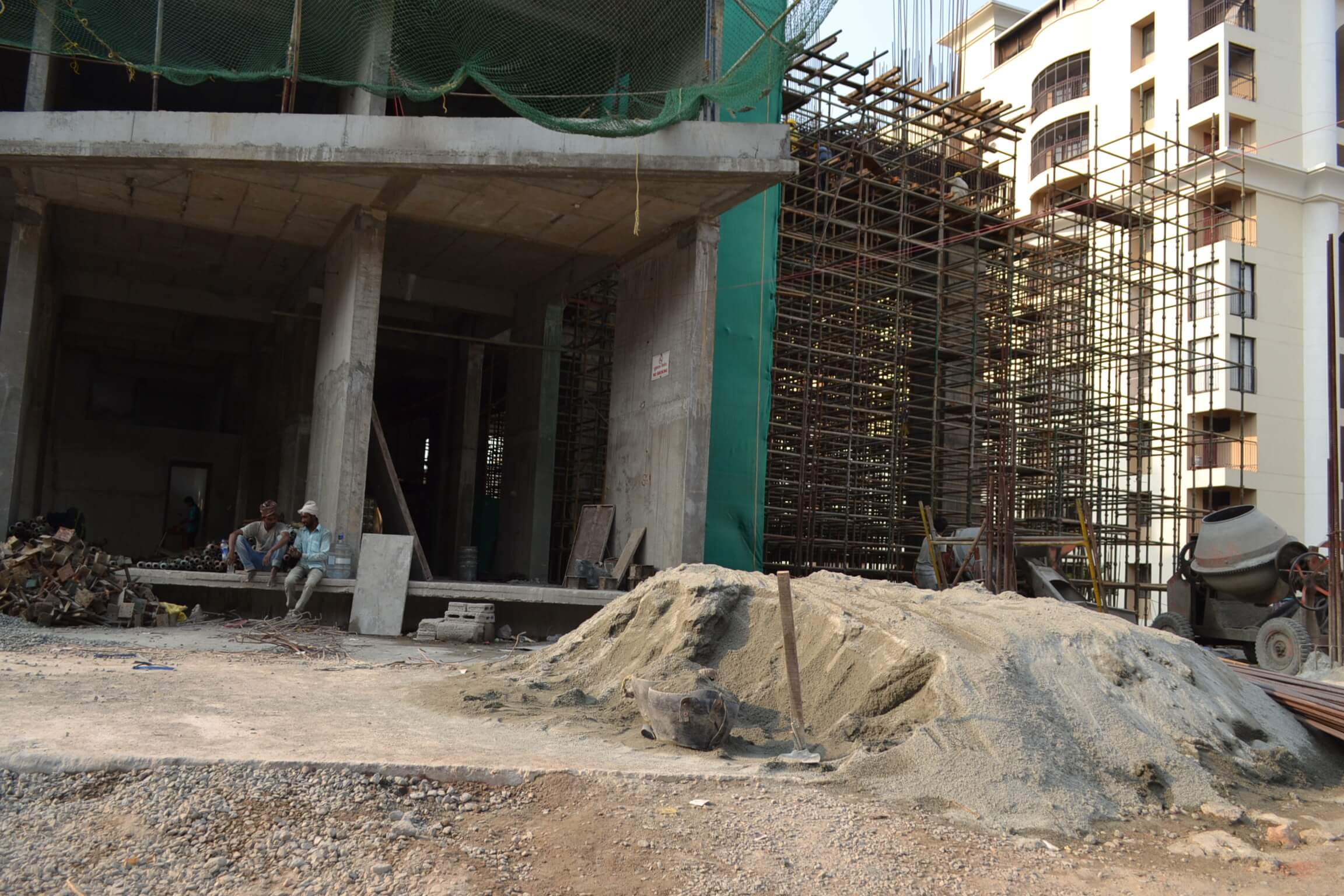

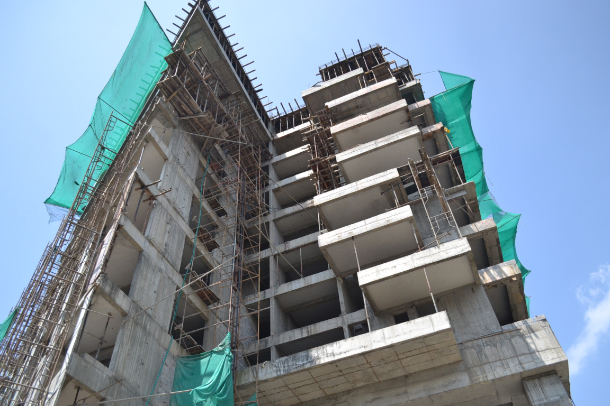

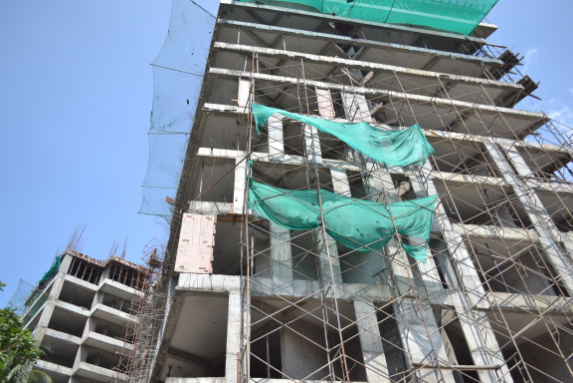

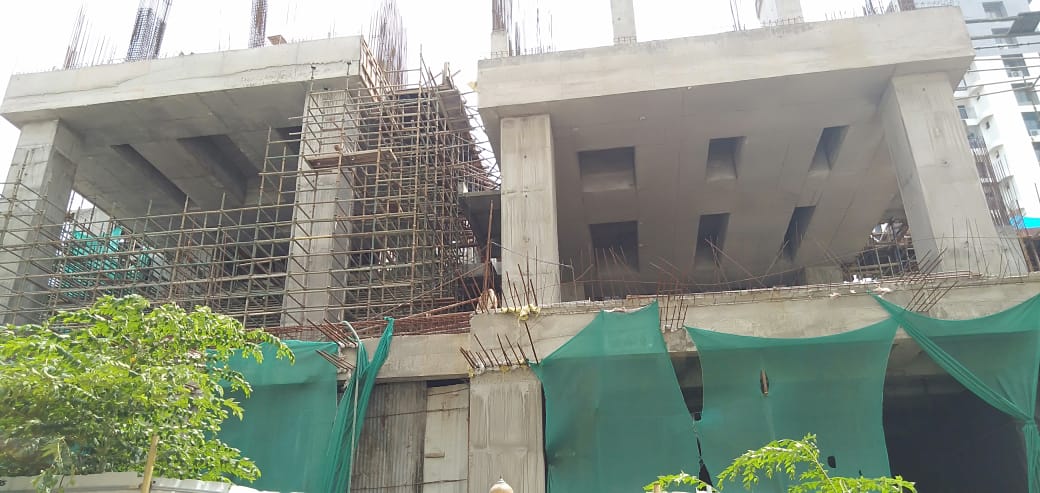

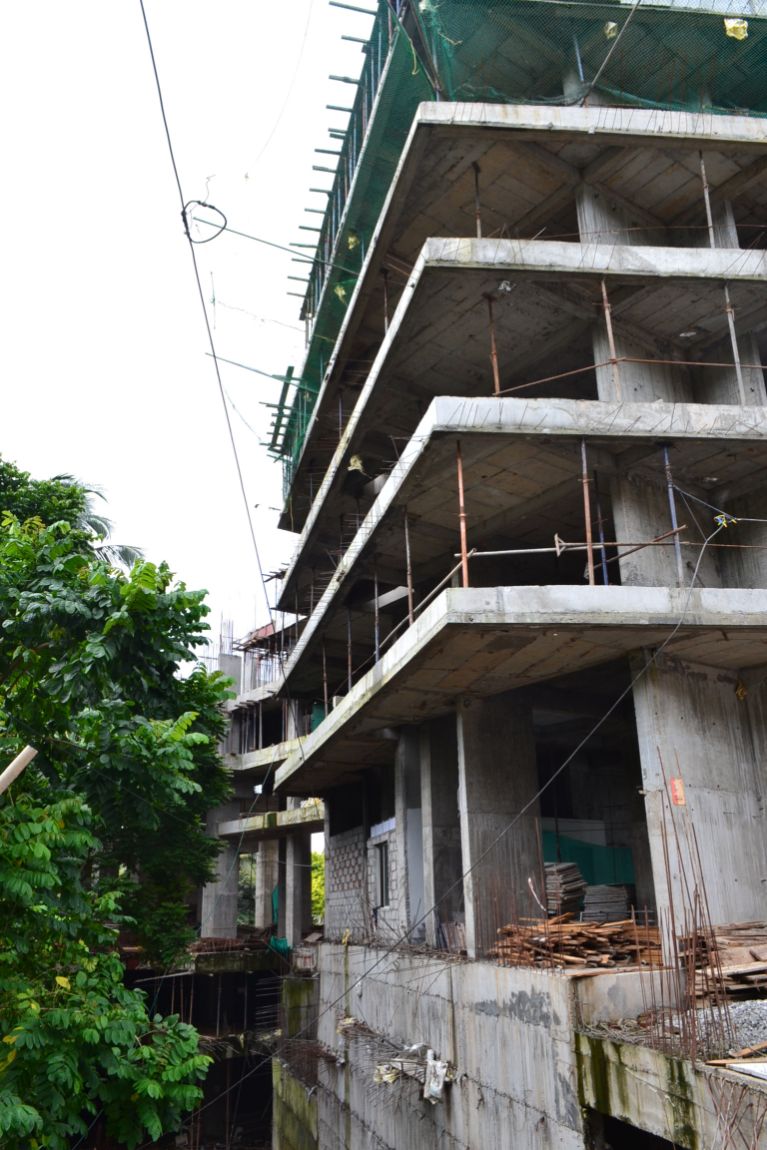

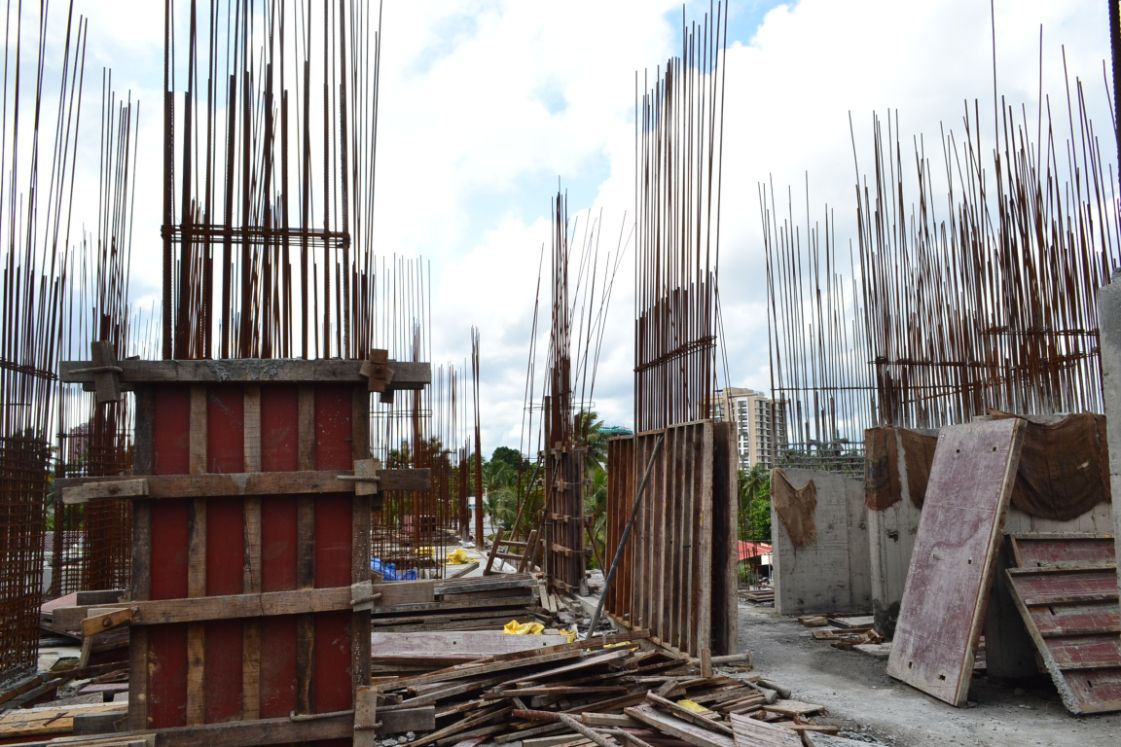

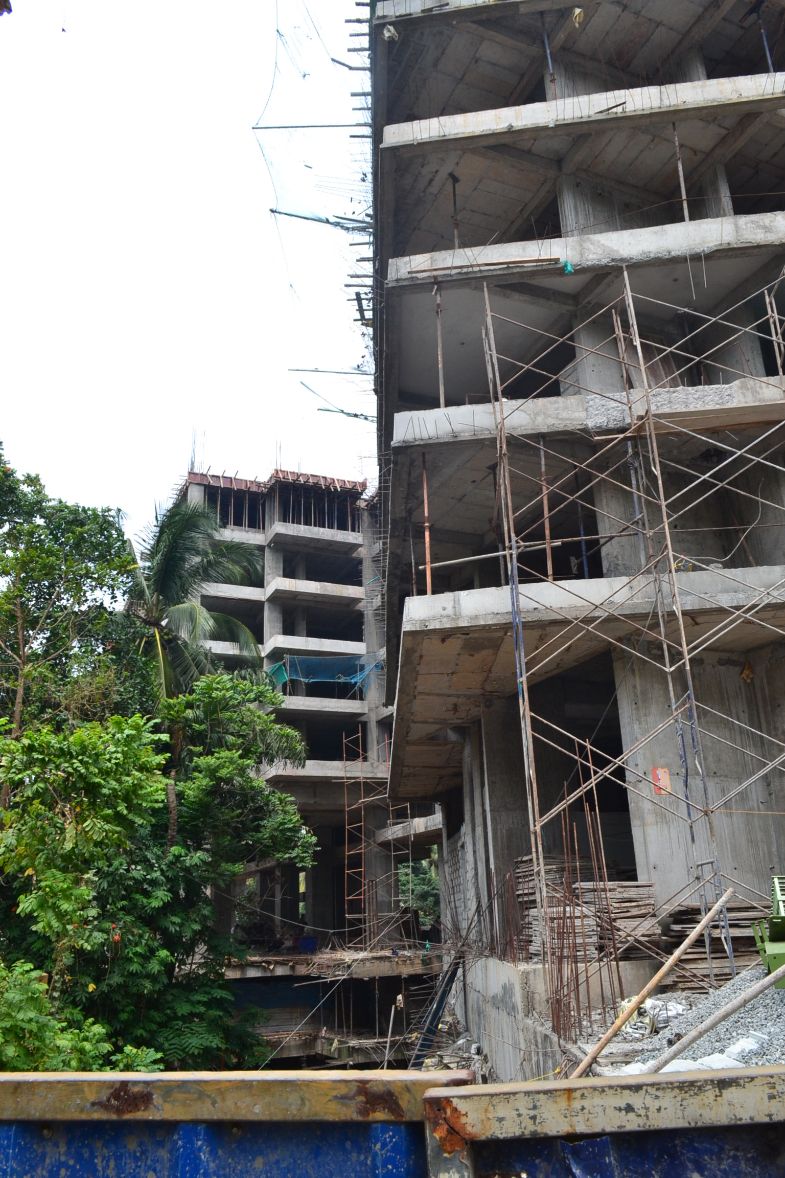

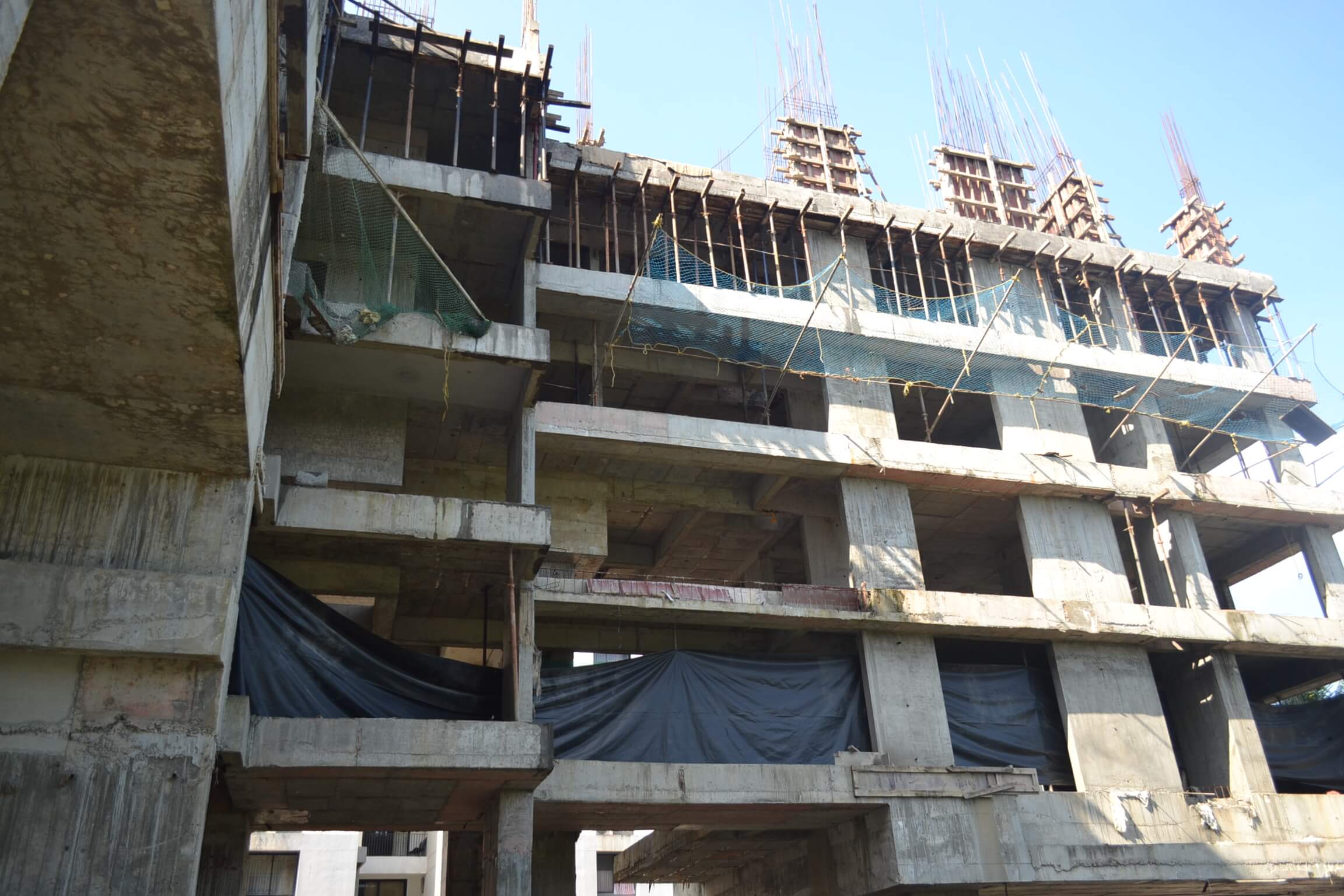

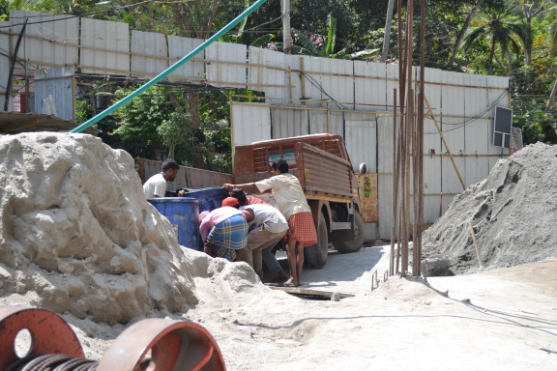

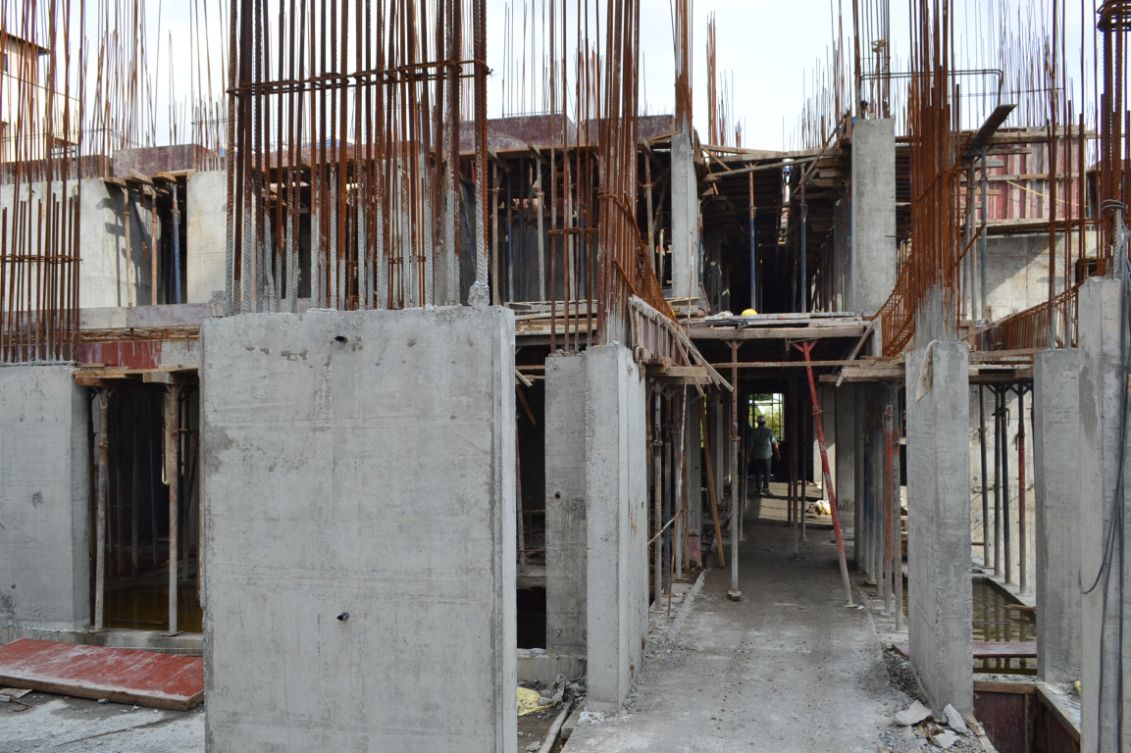

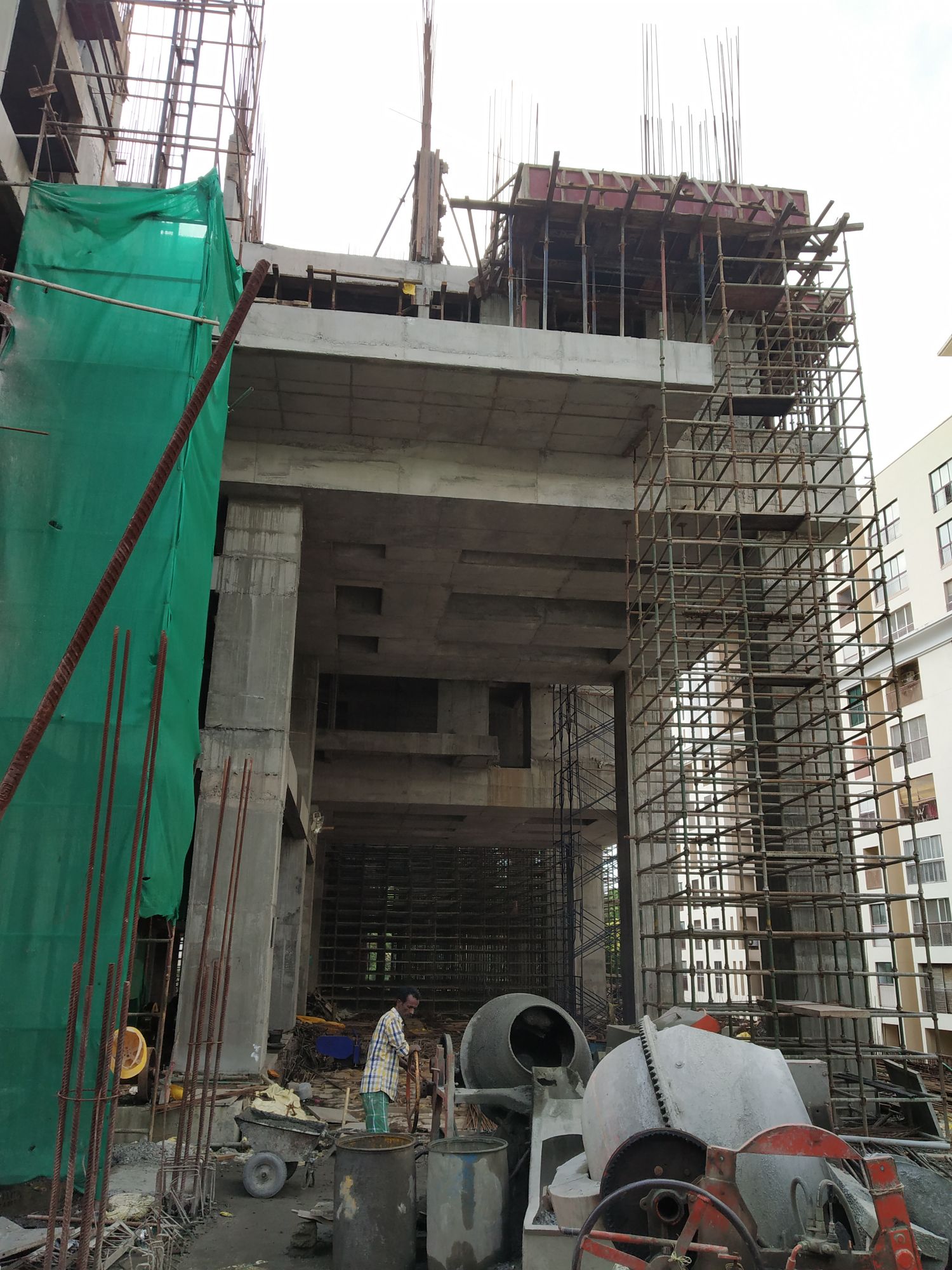

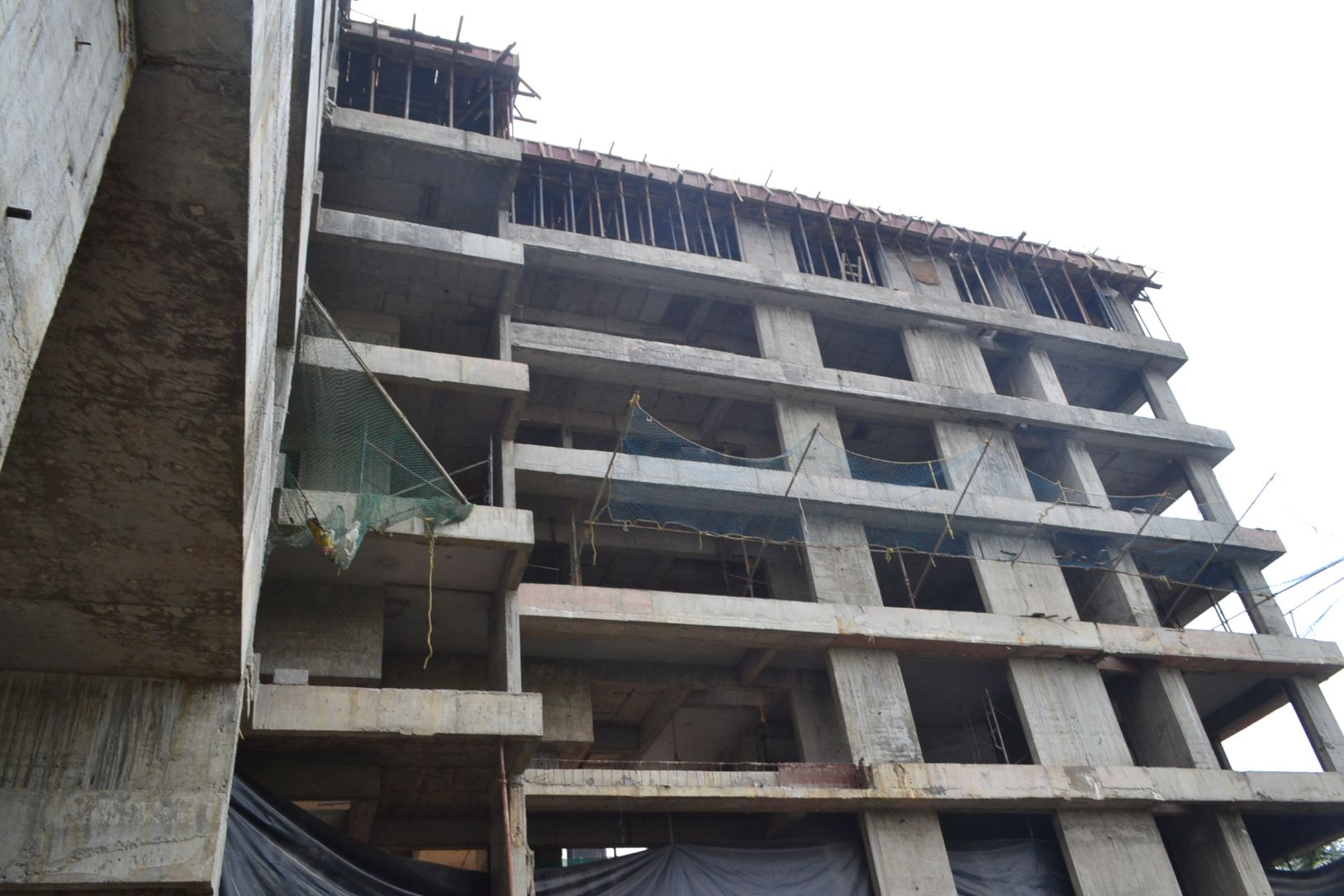

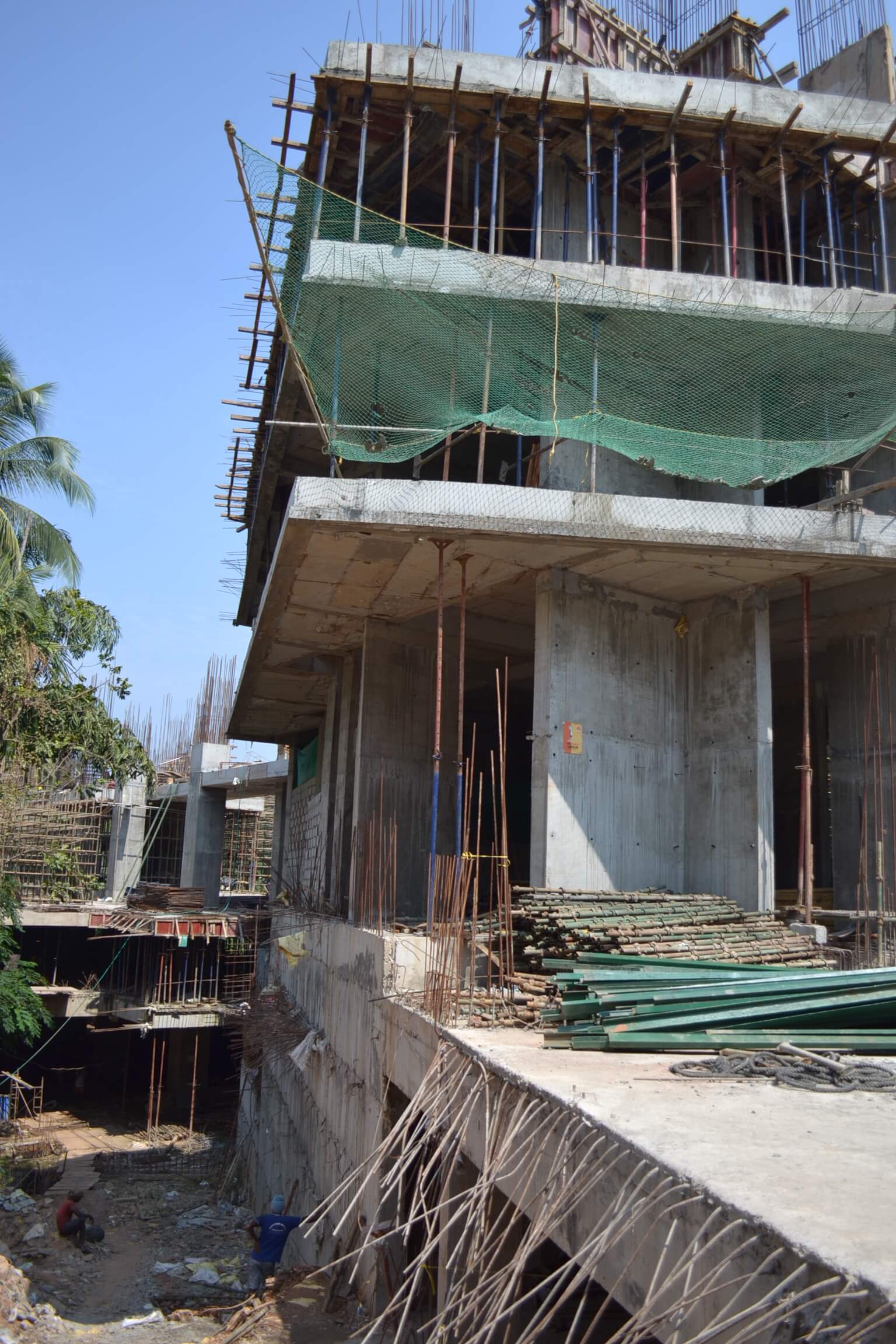

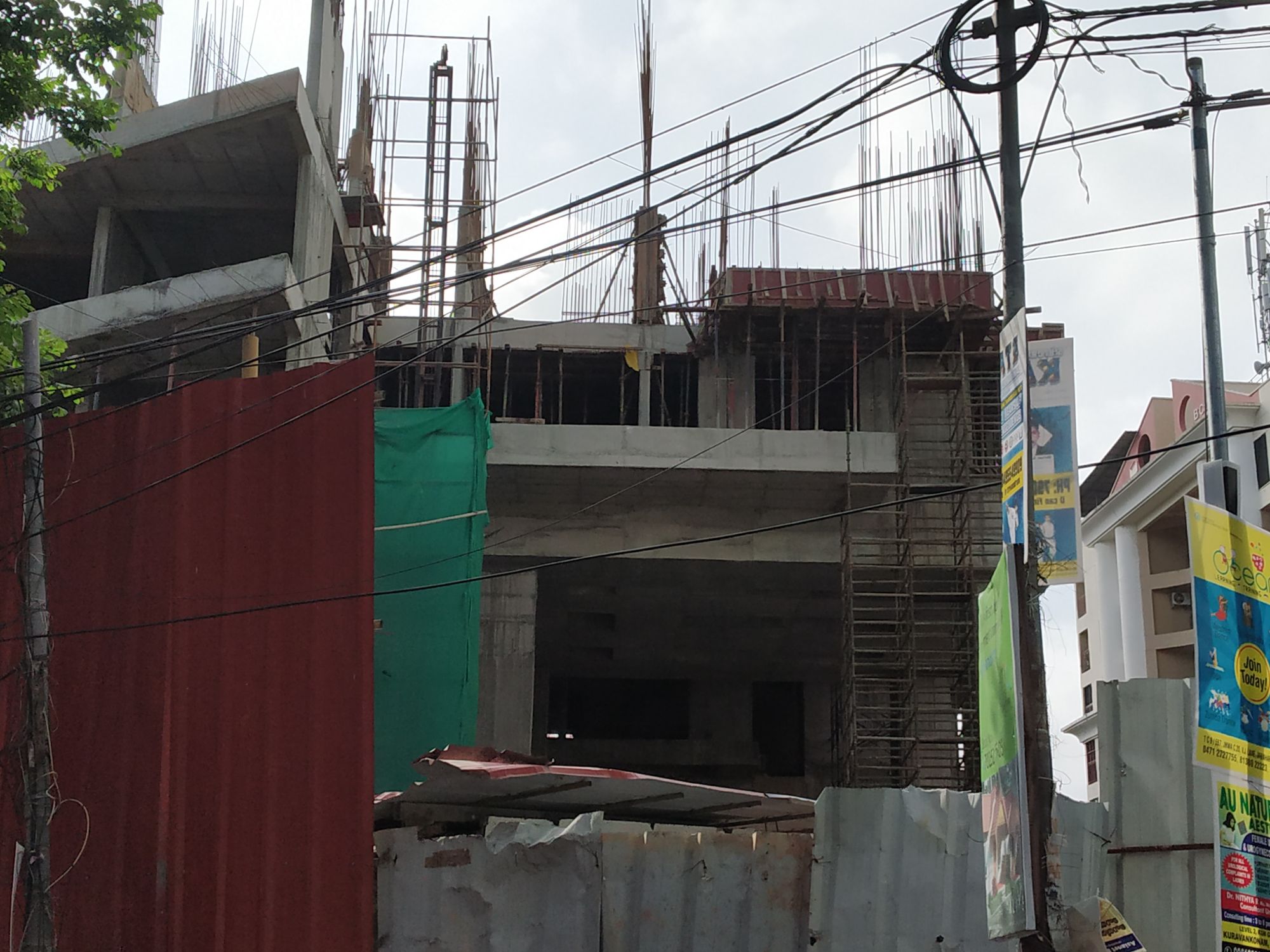

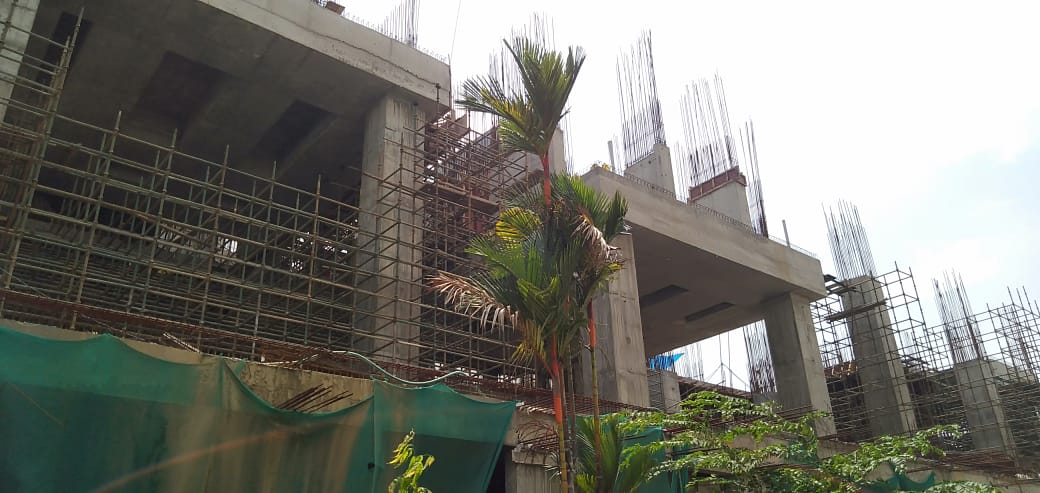

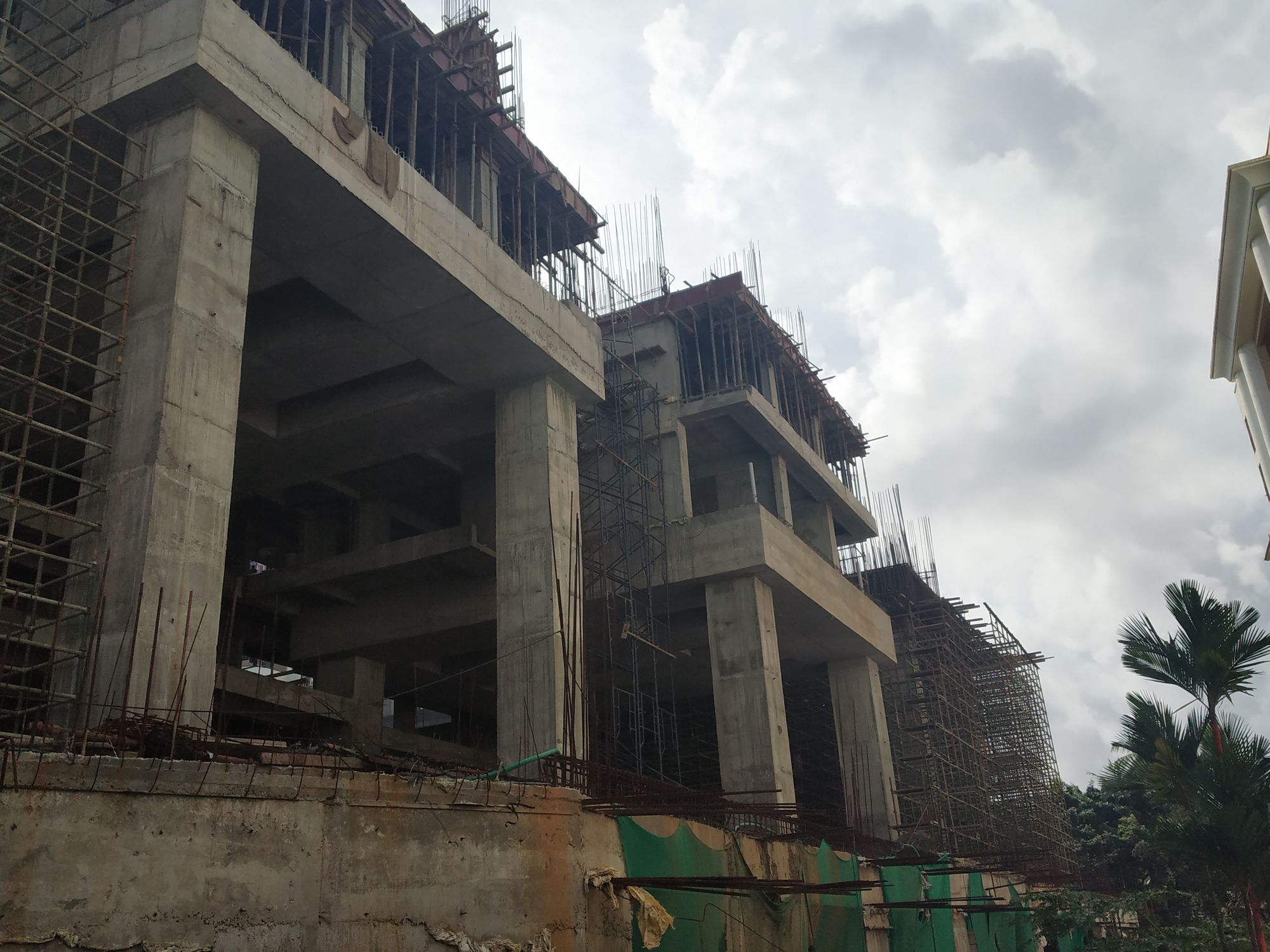

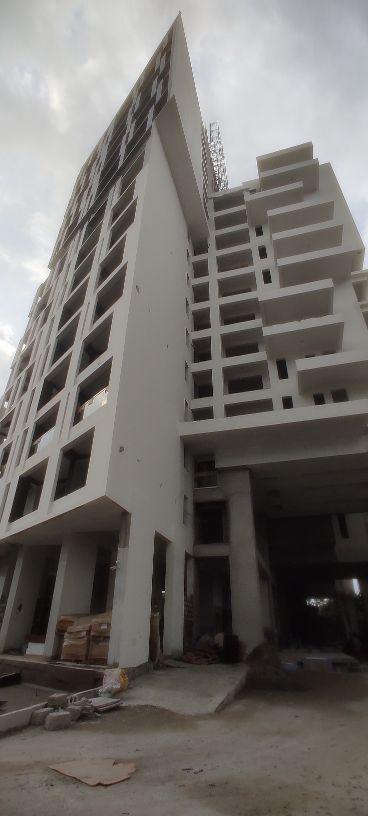

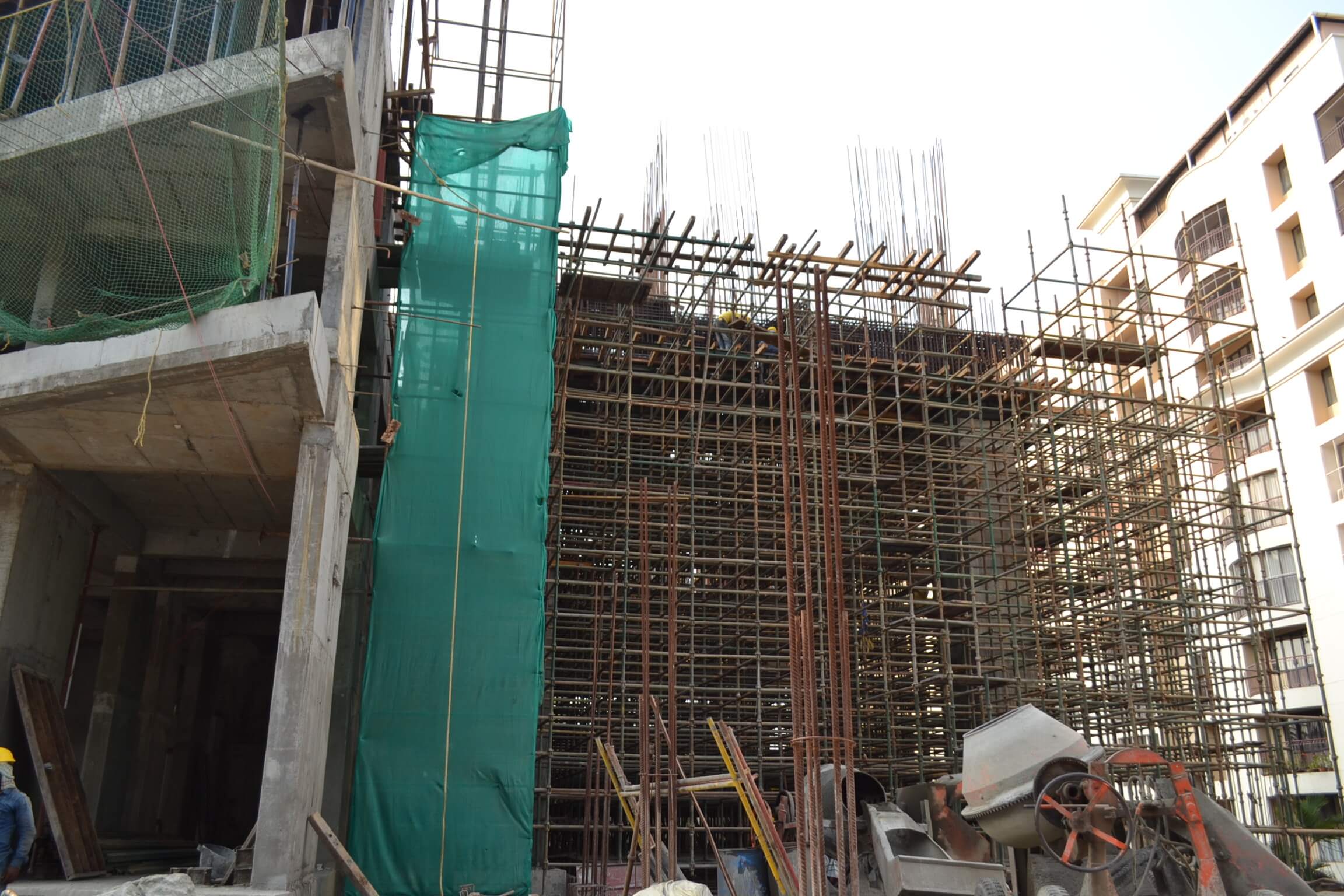

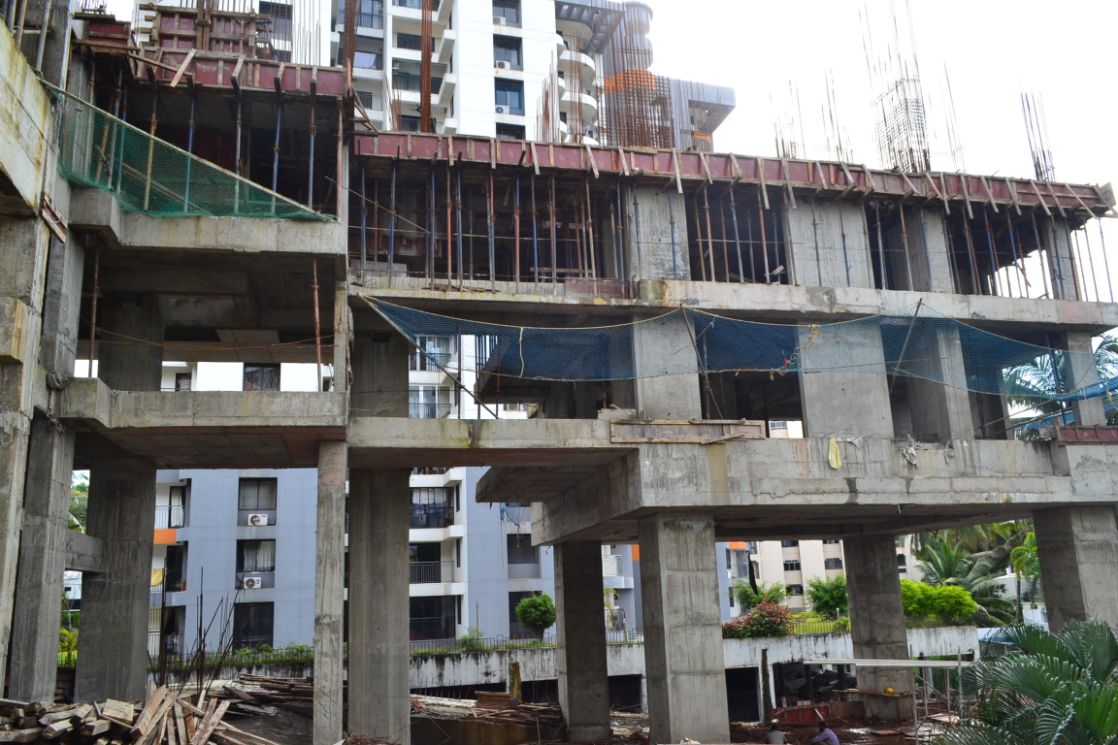

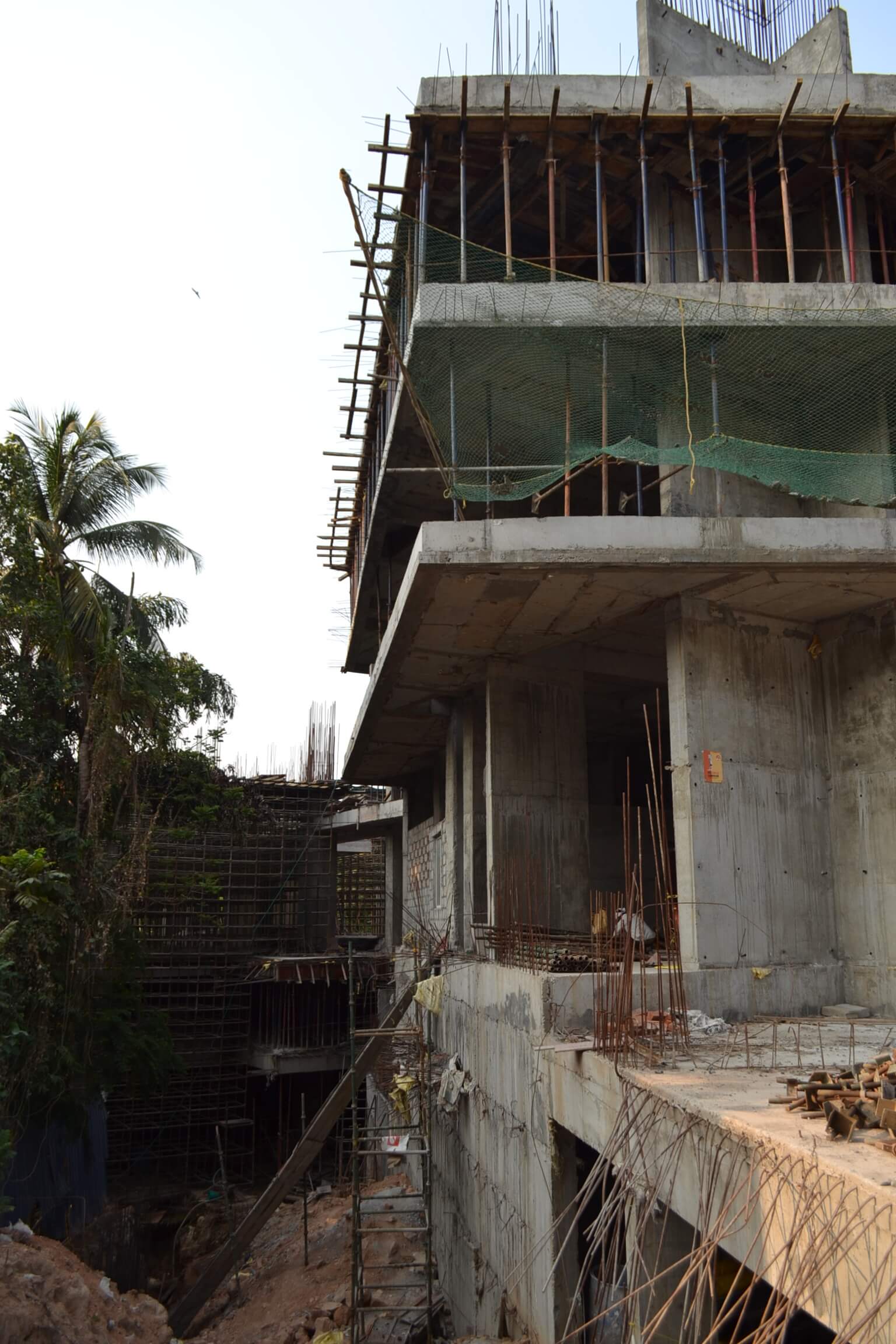

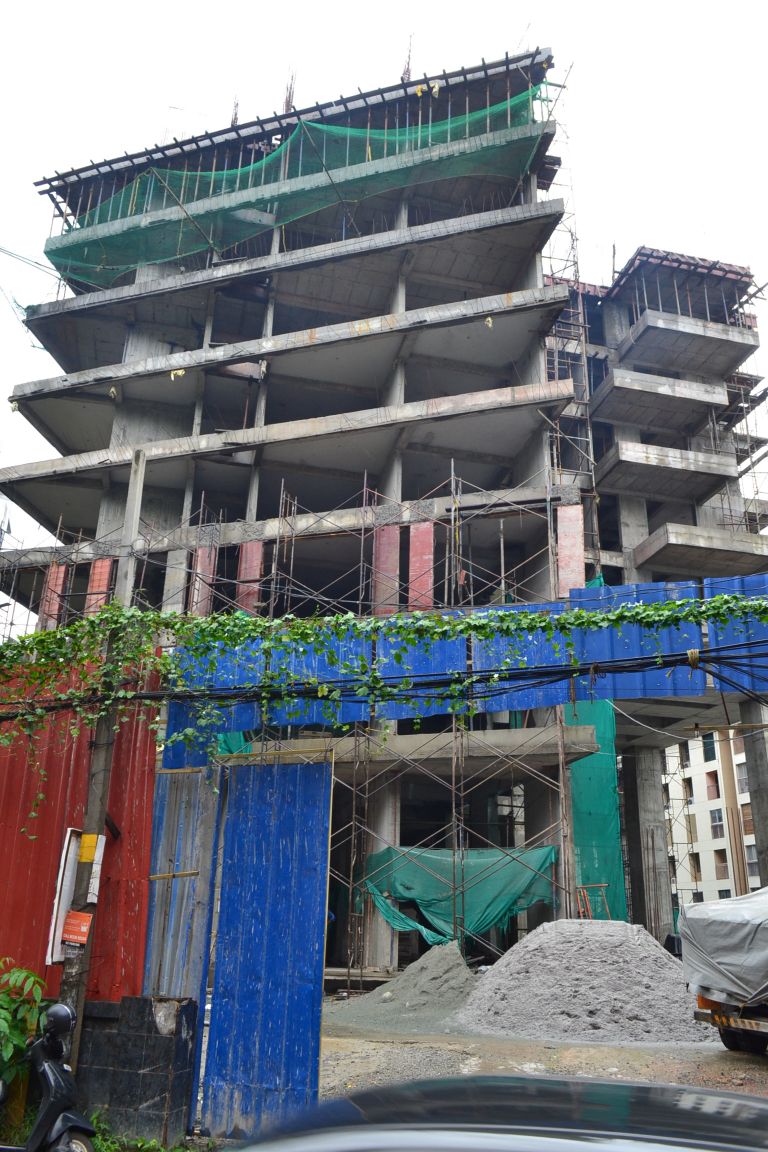

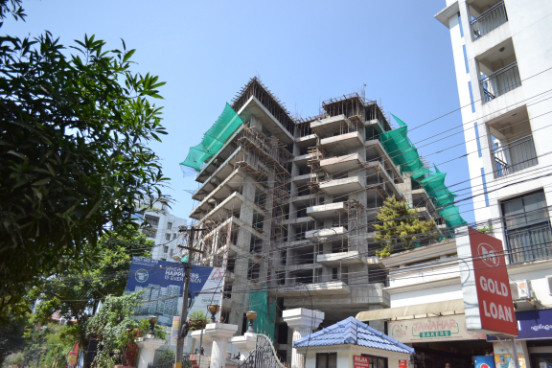

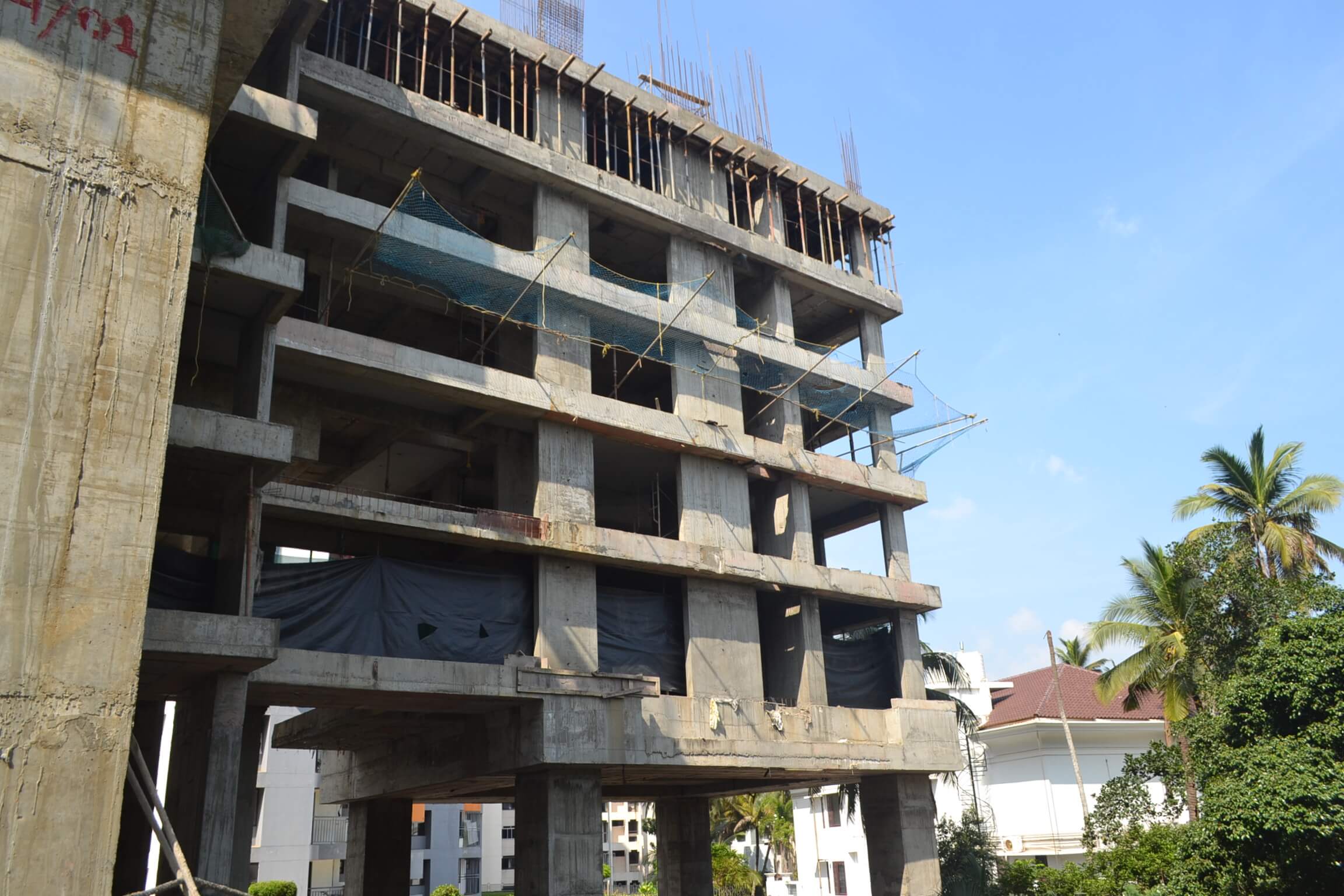

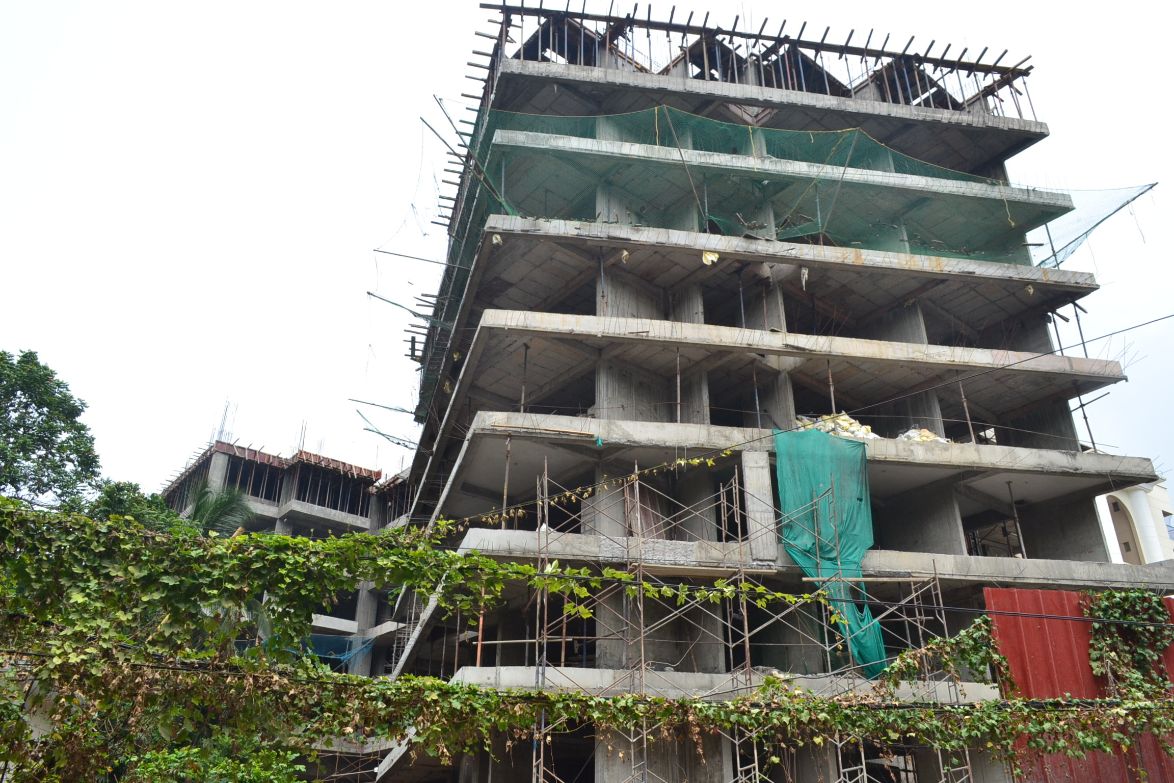

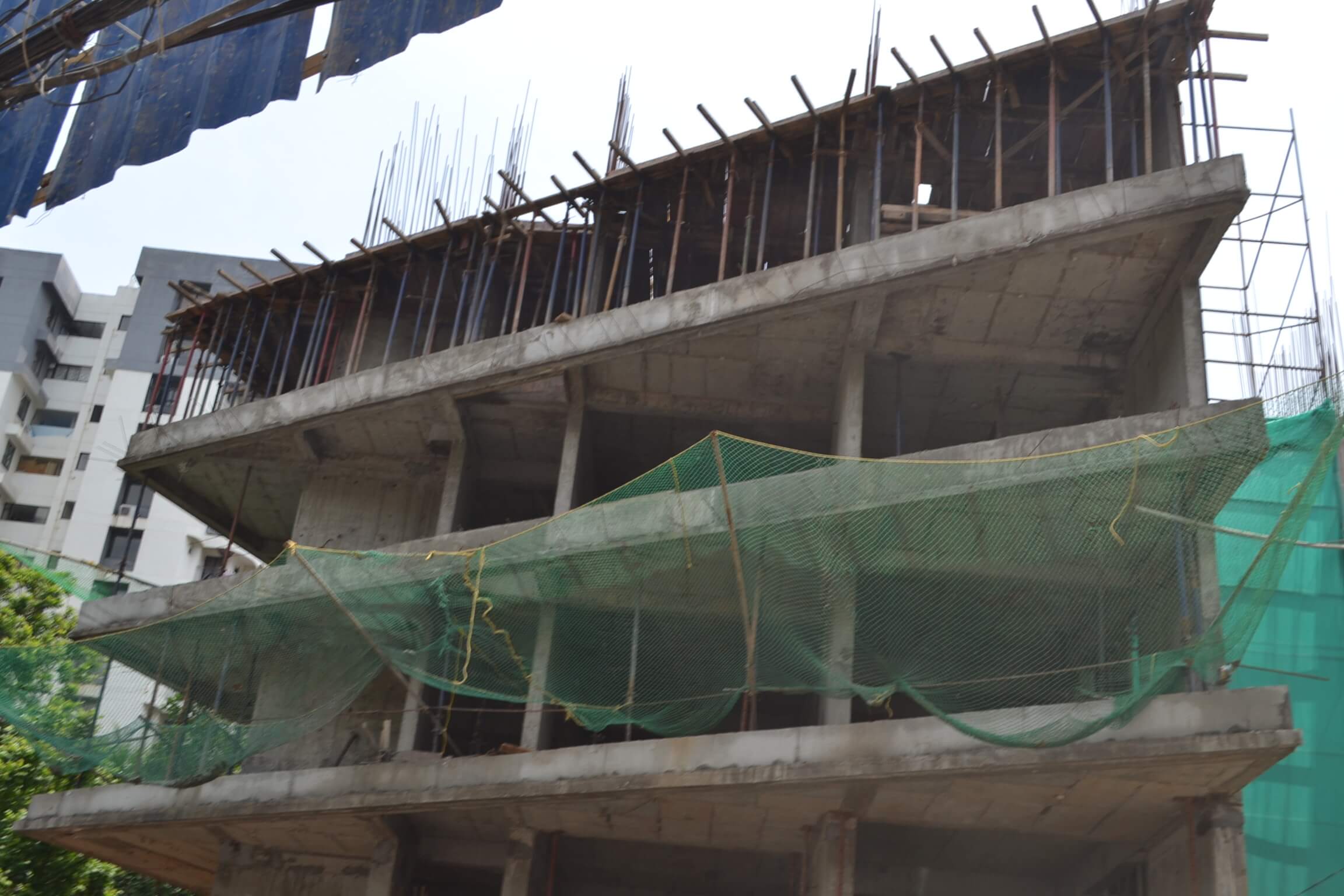

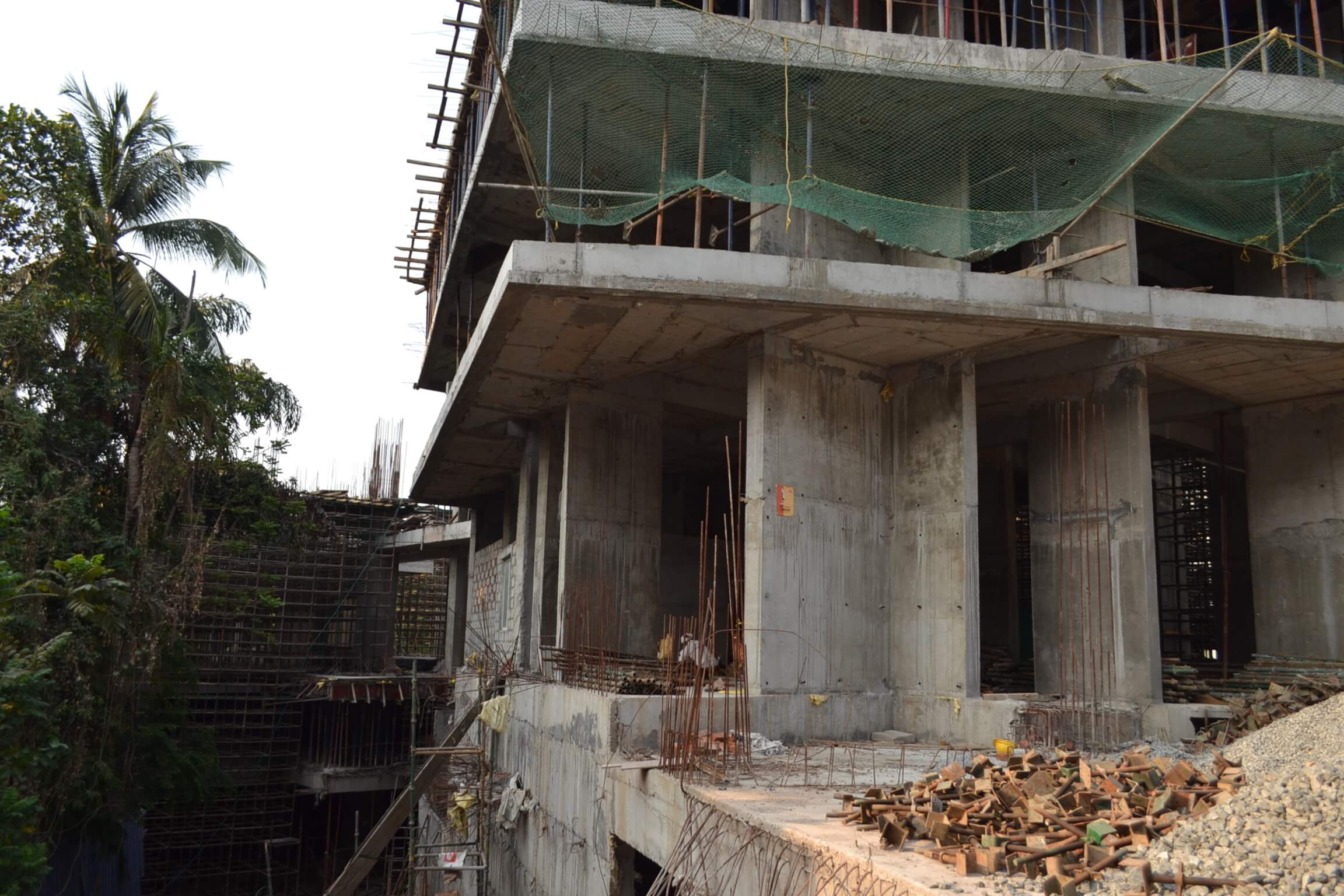

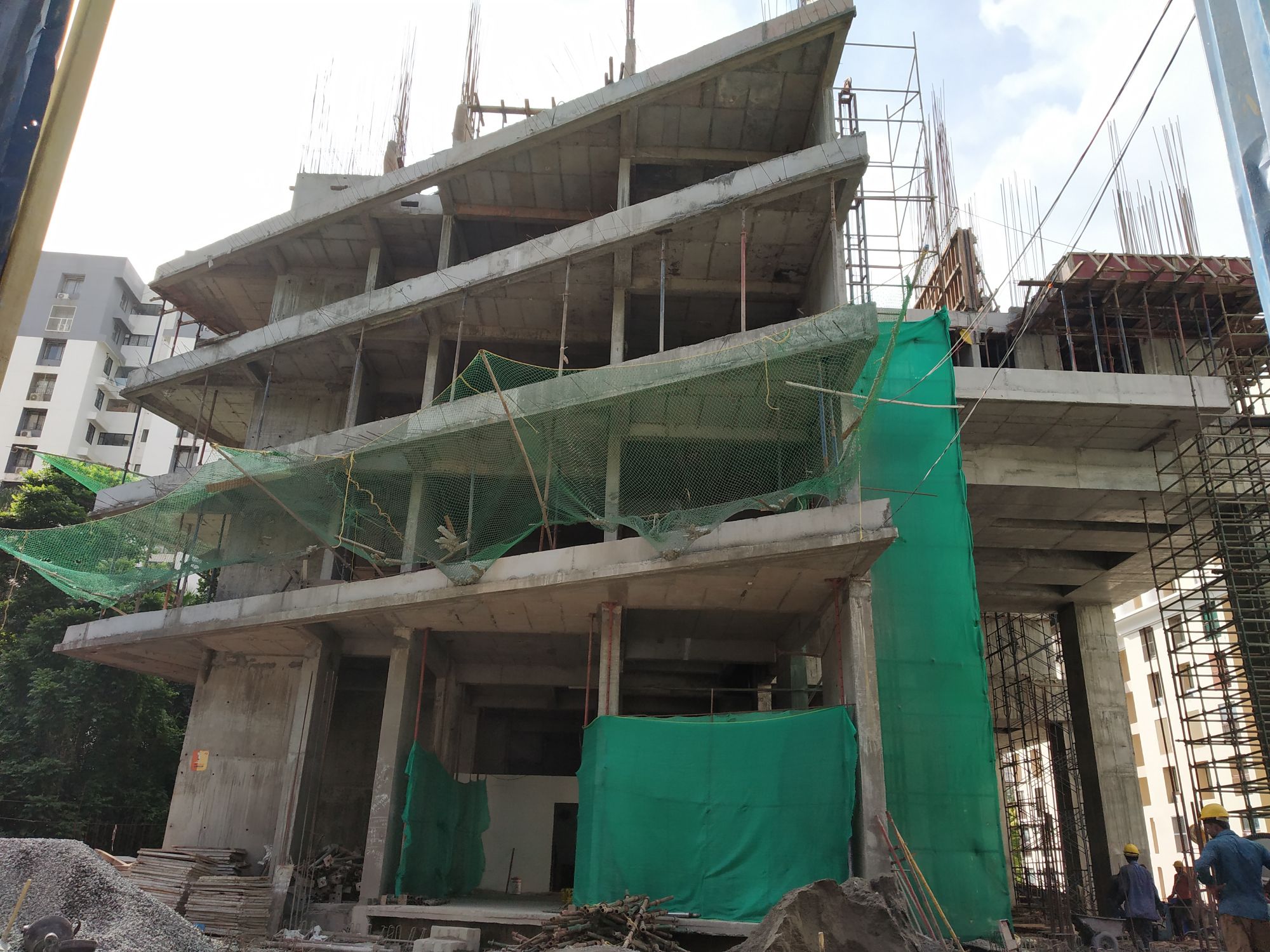

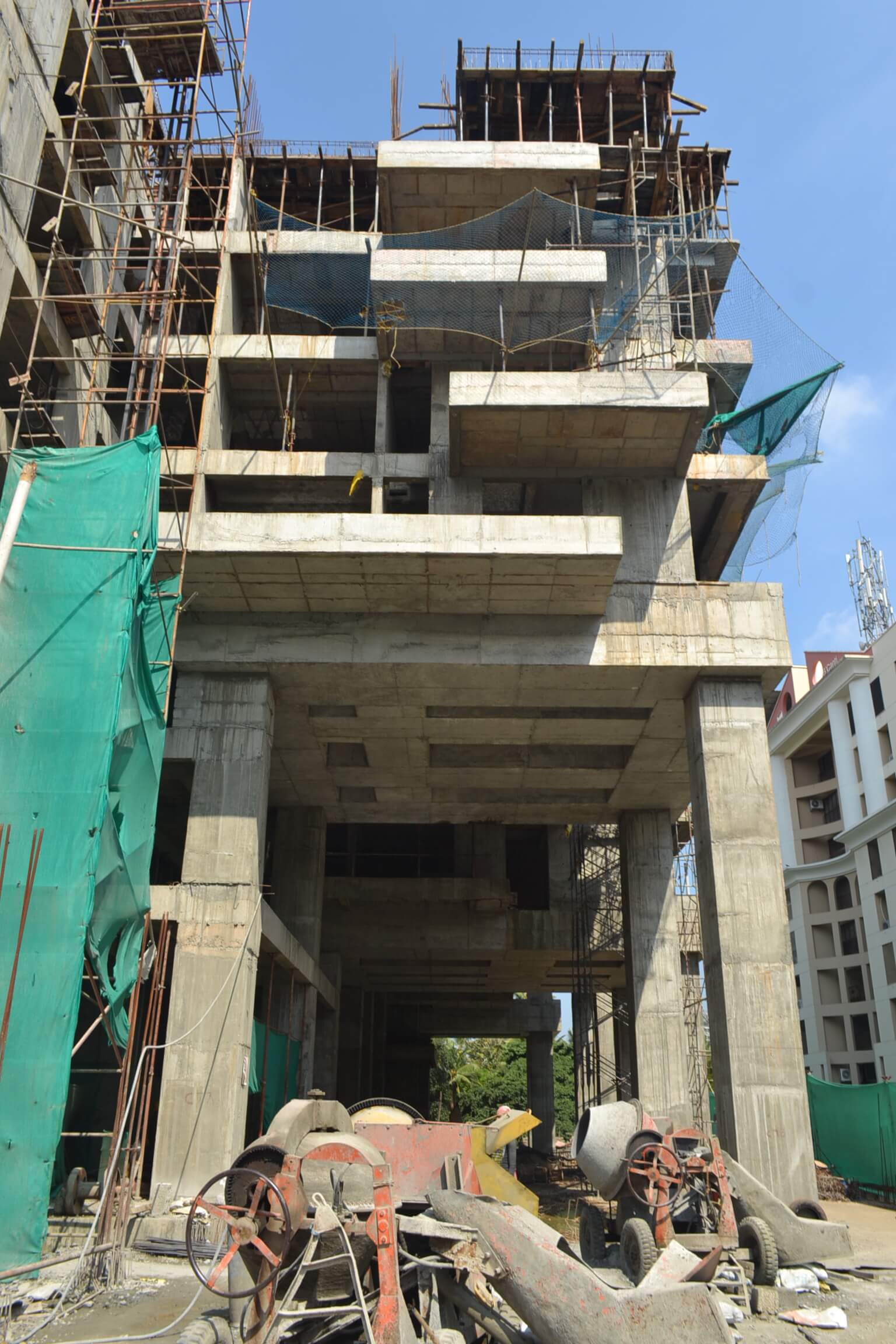

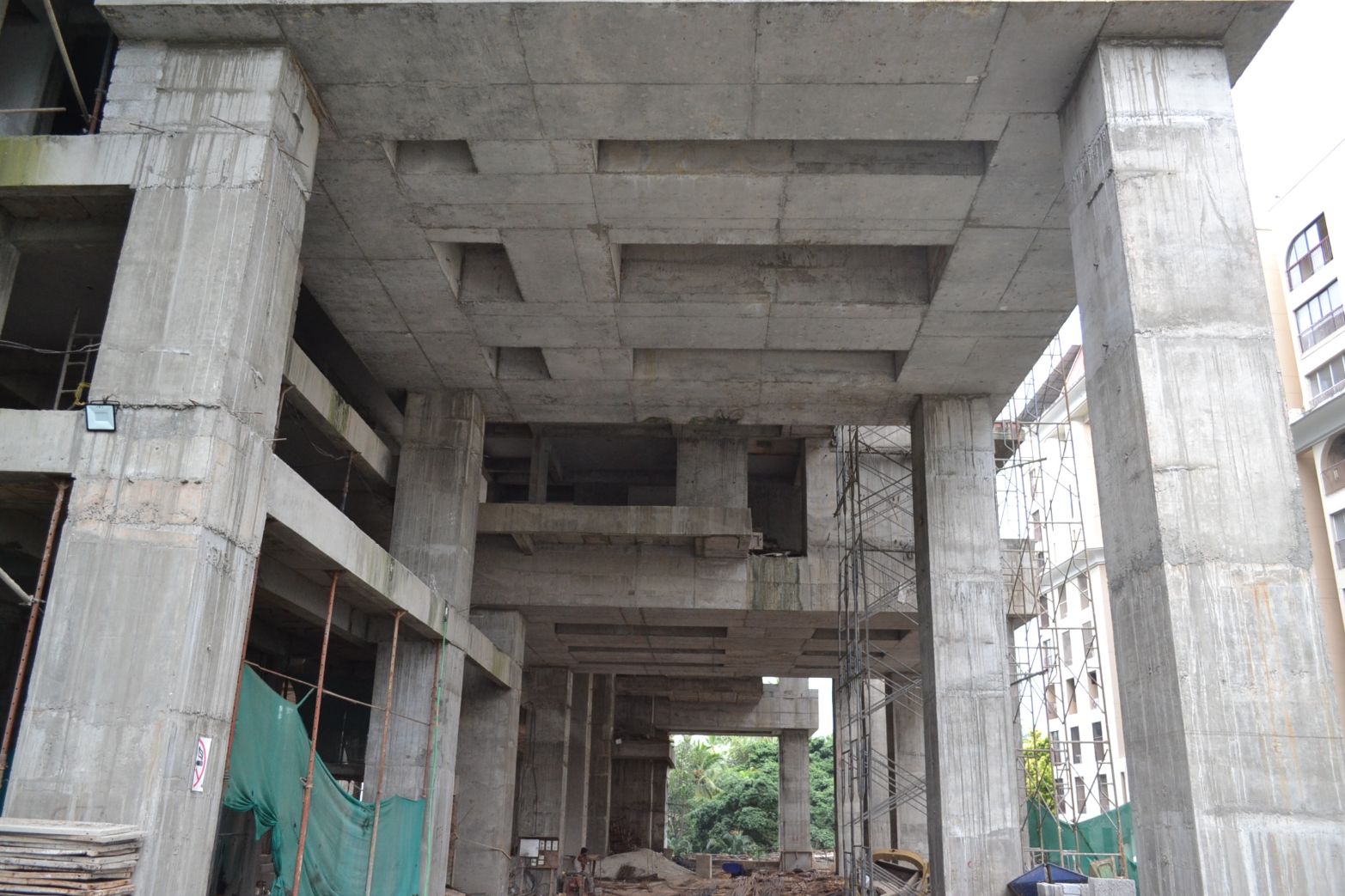

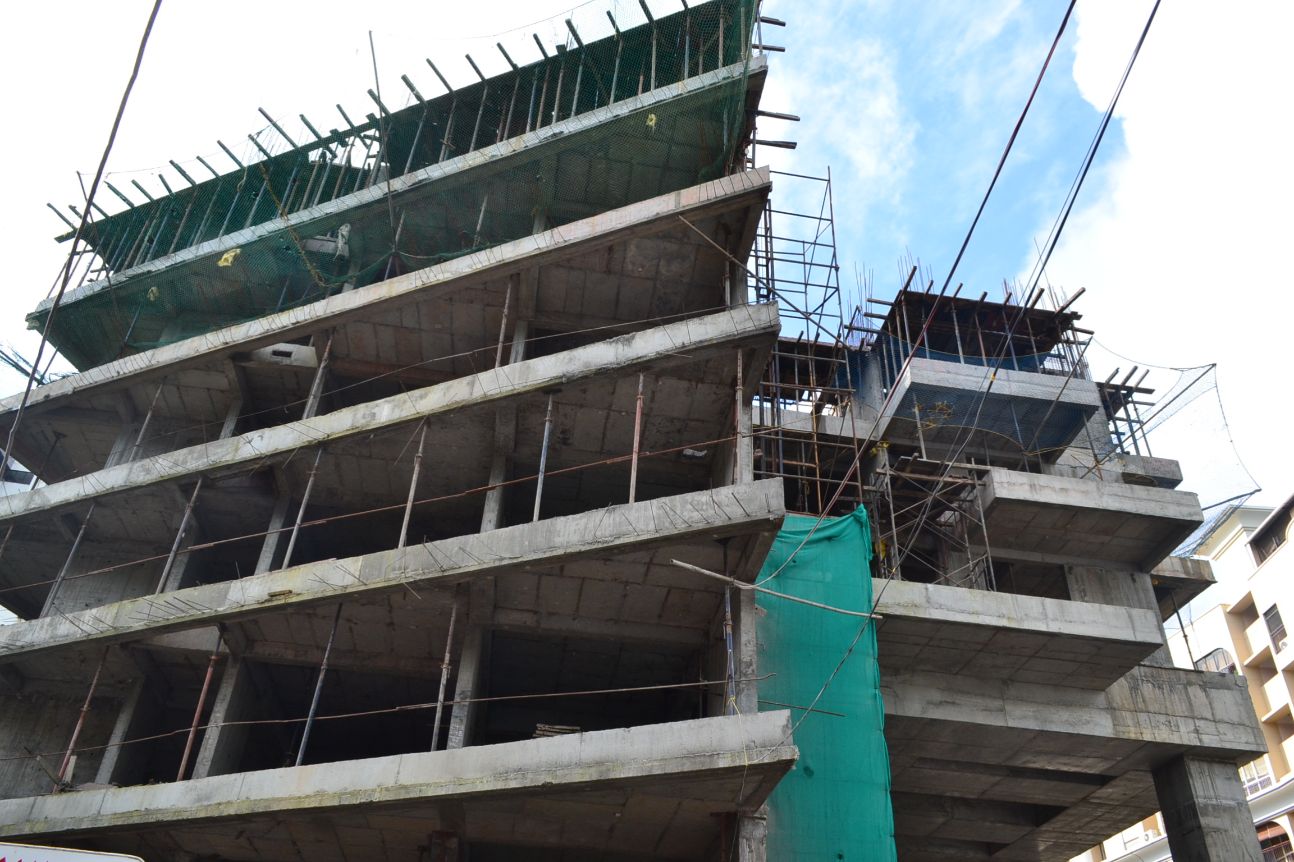

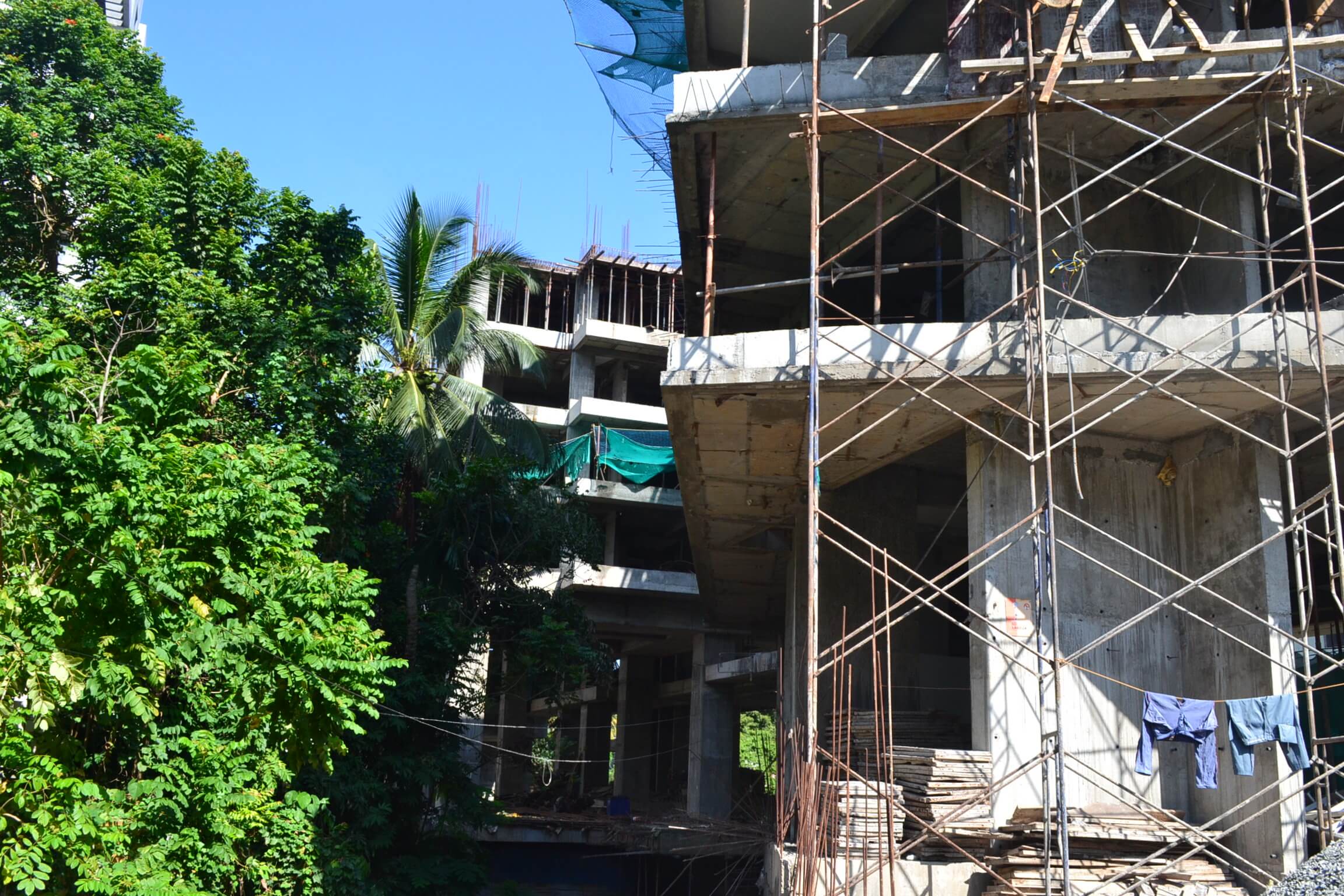

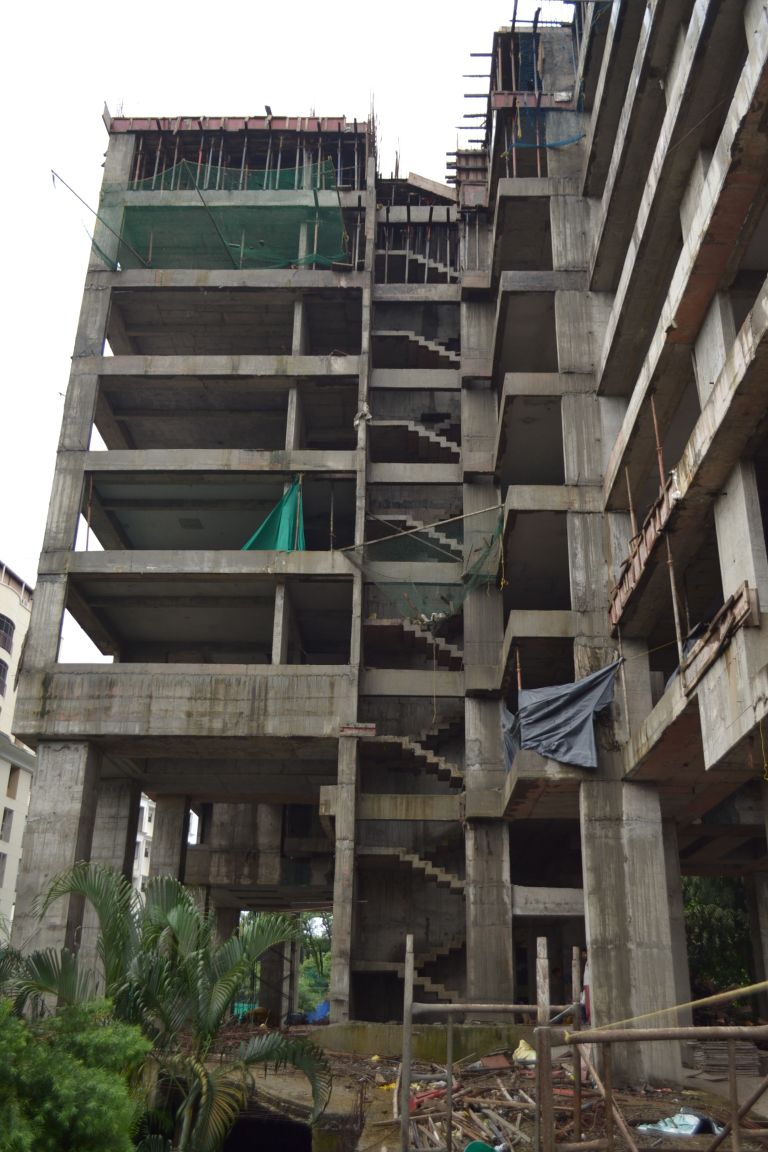

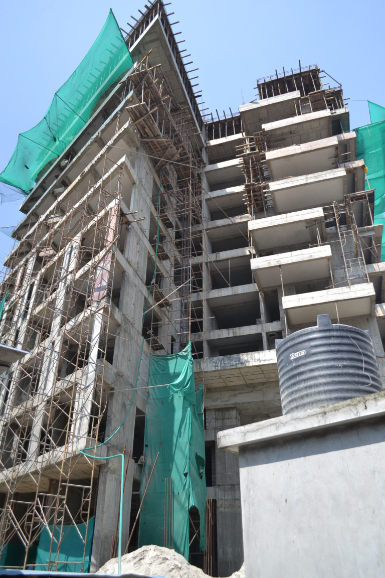

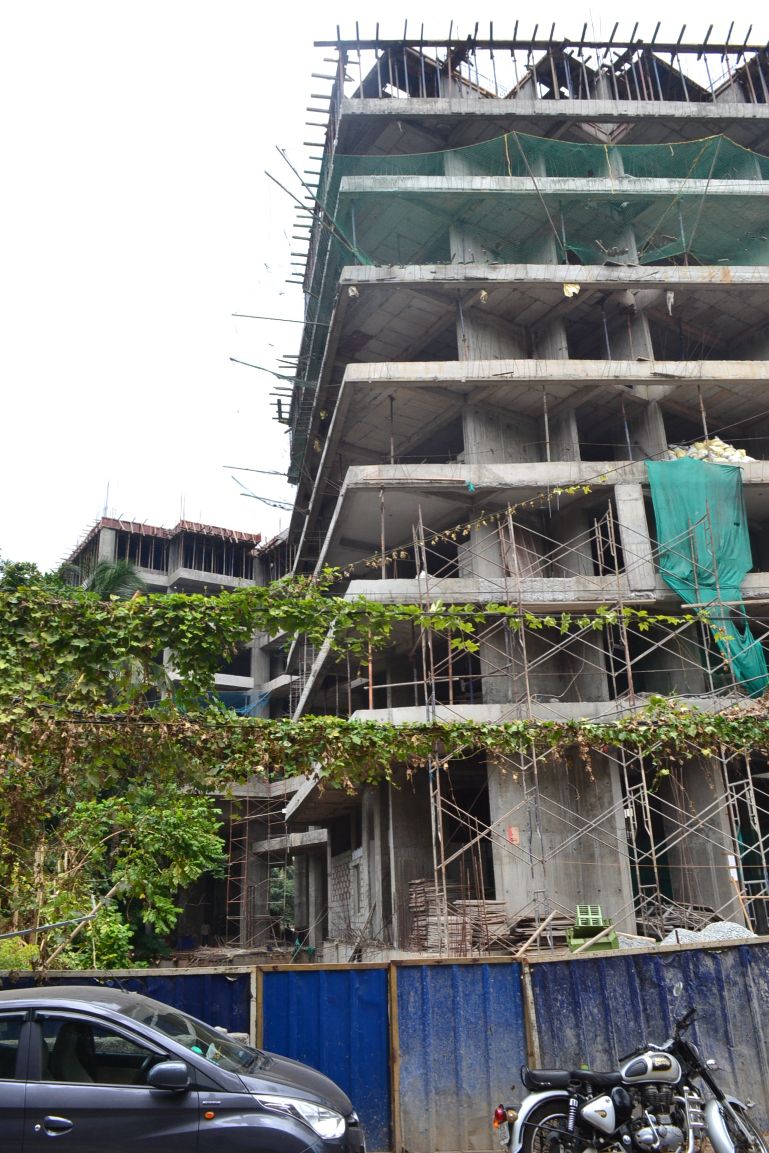

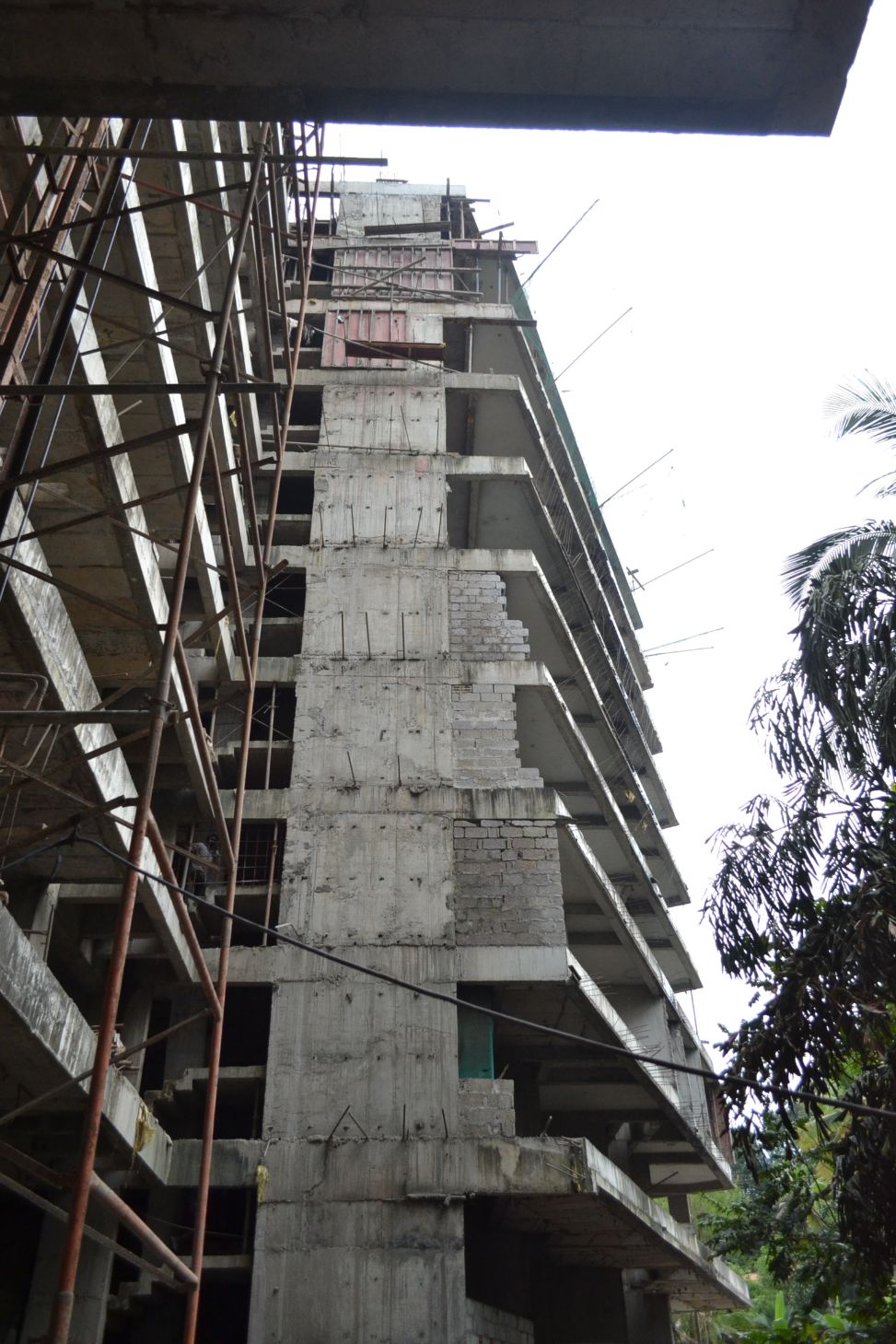

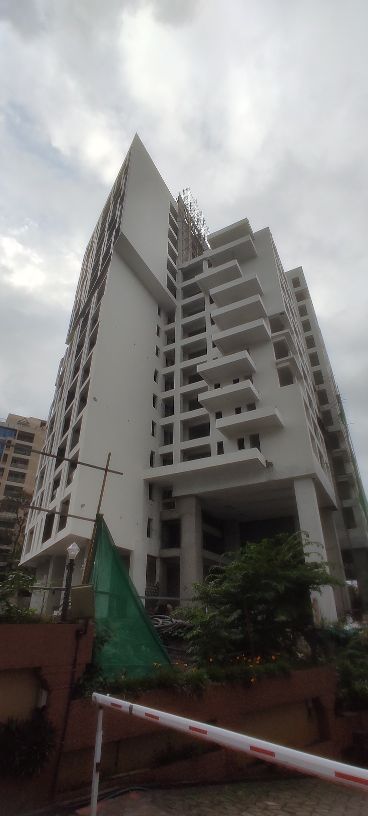

Artech Rainforest - Progress

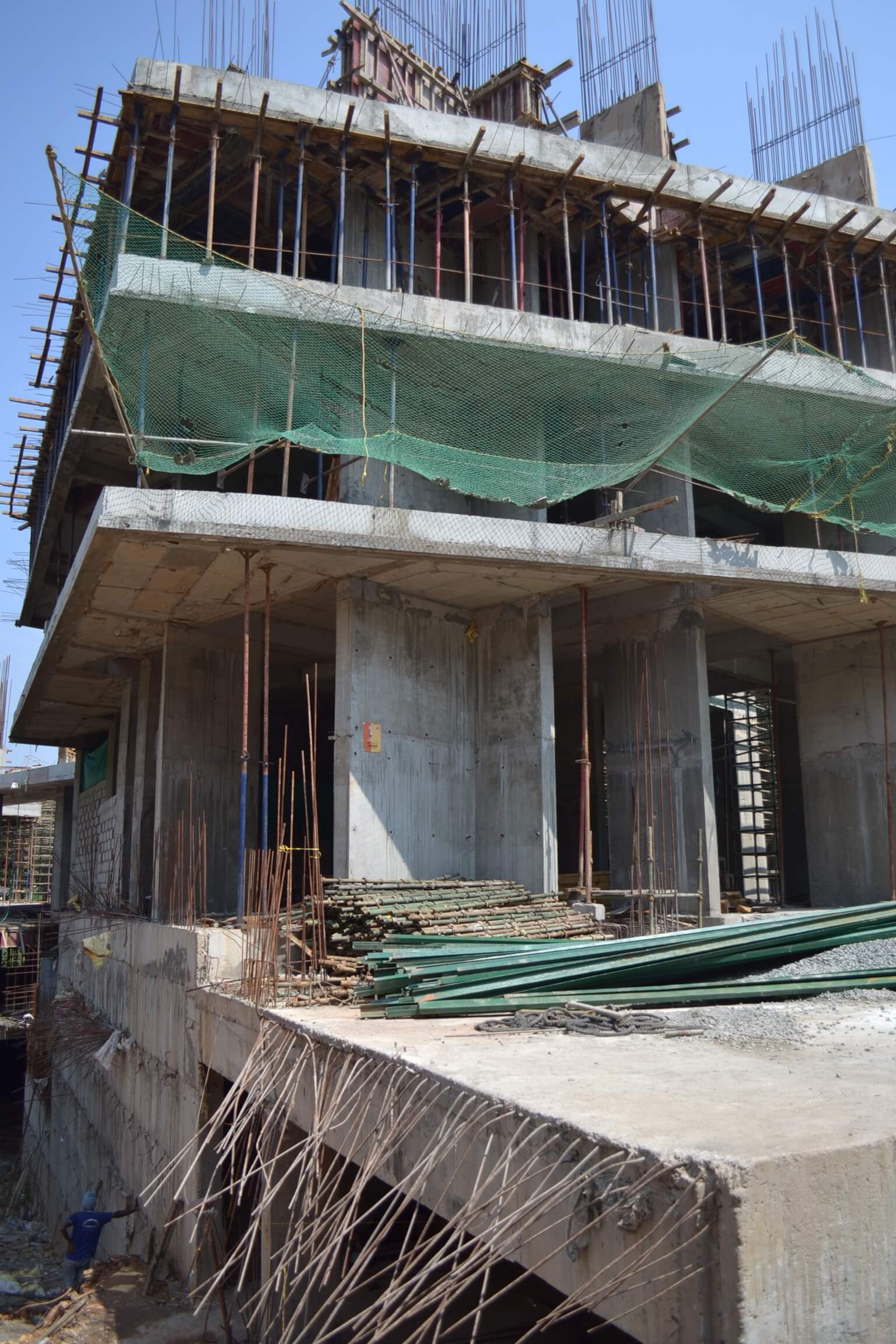

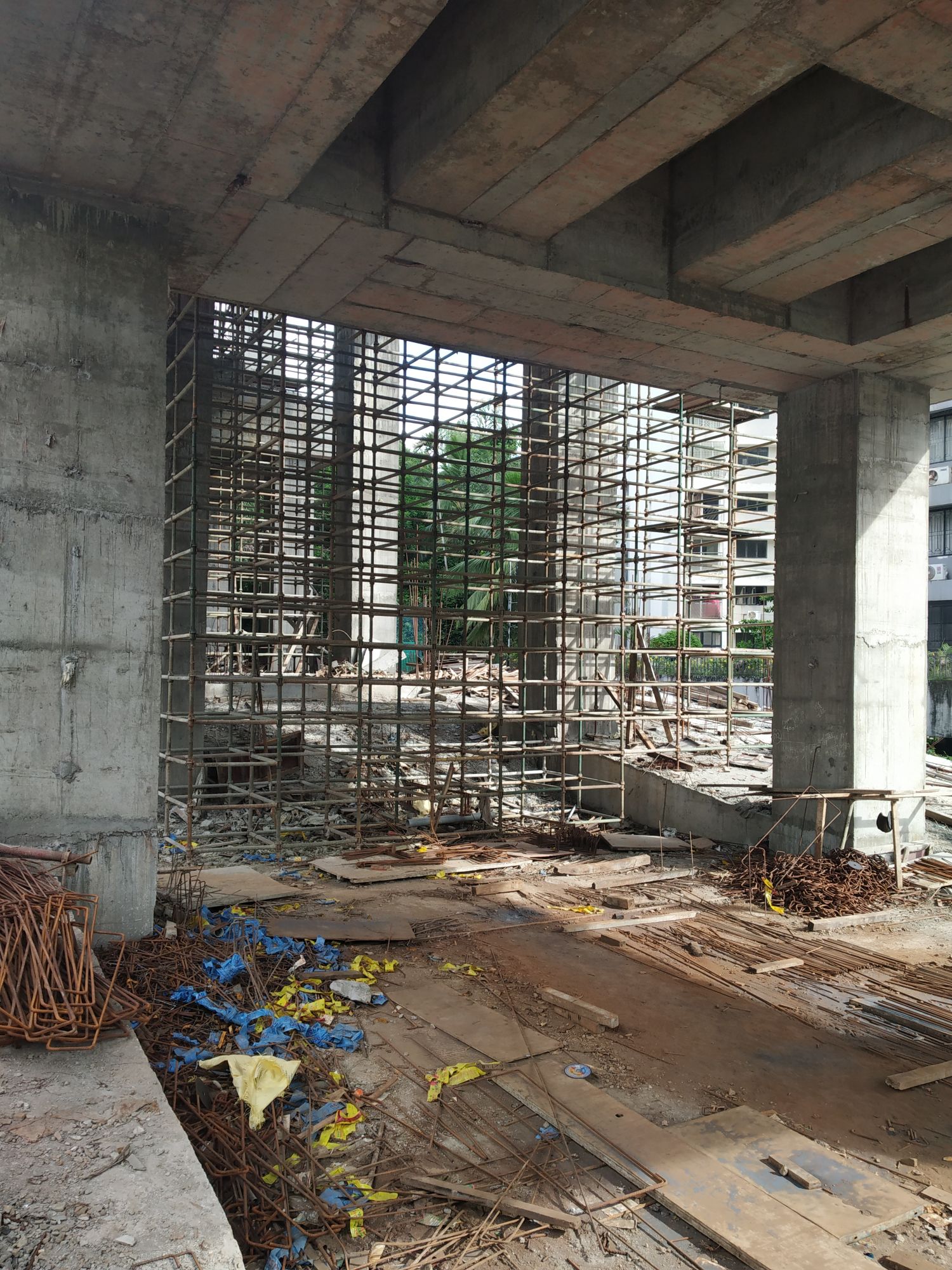

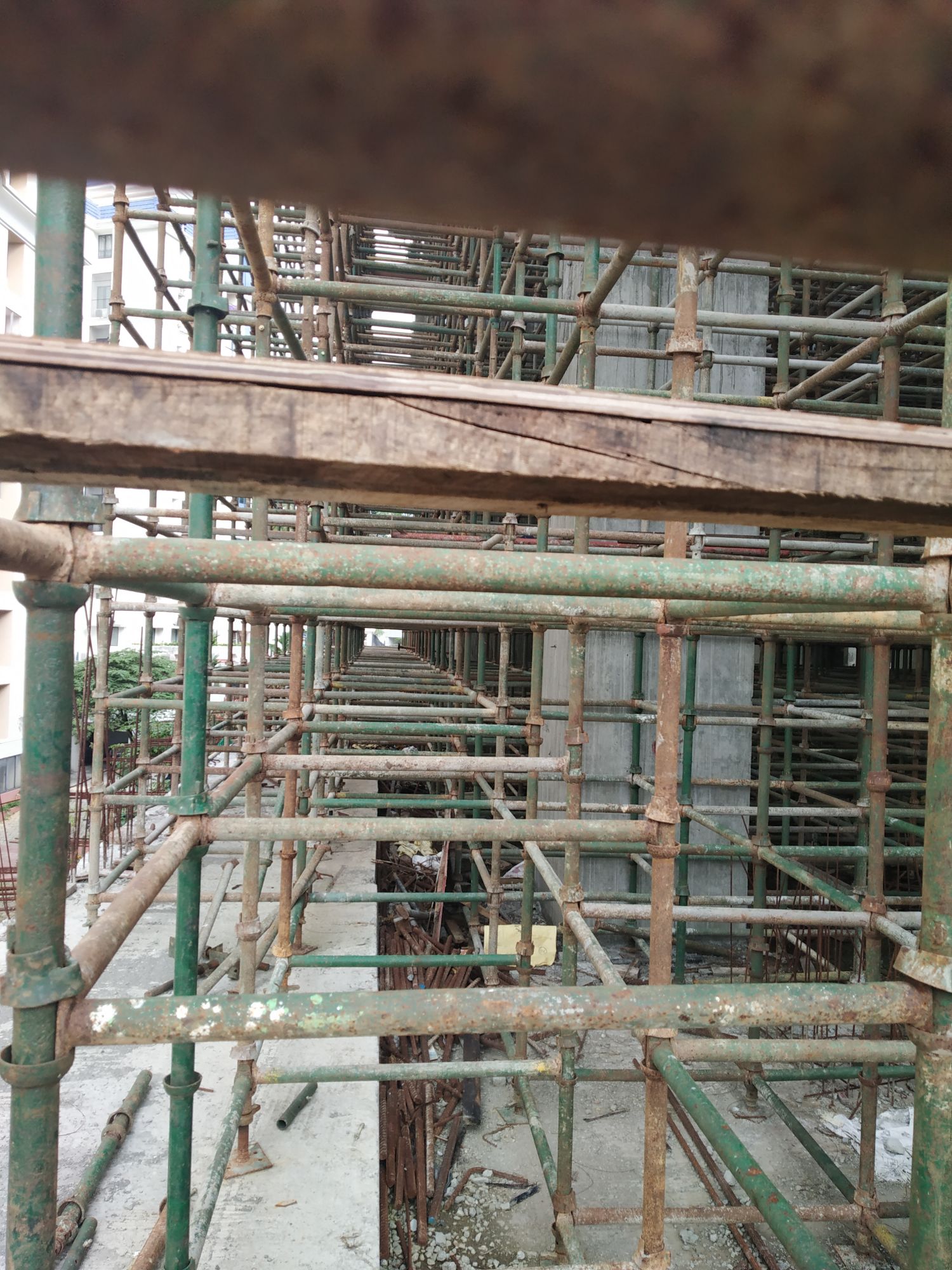

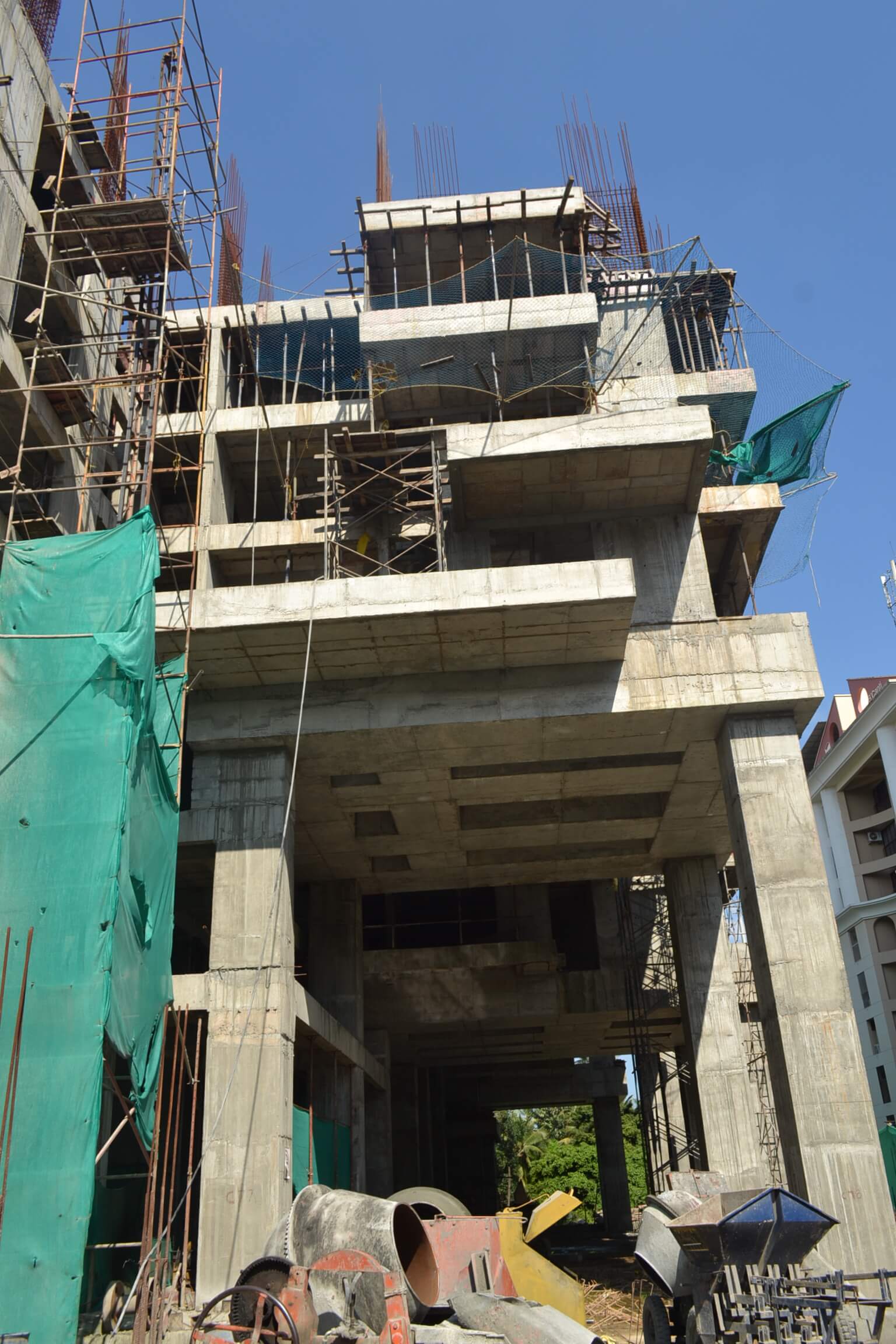

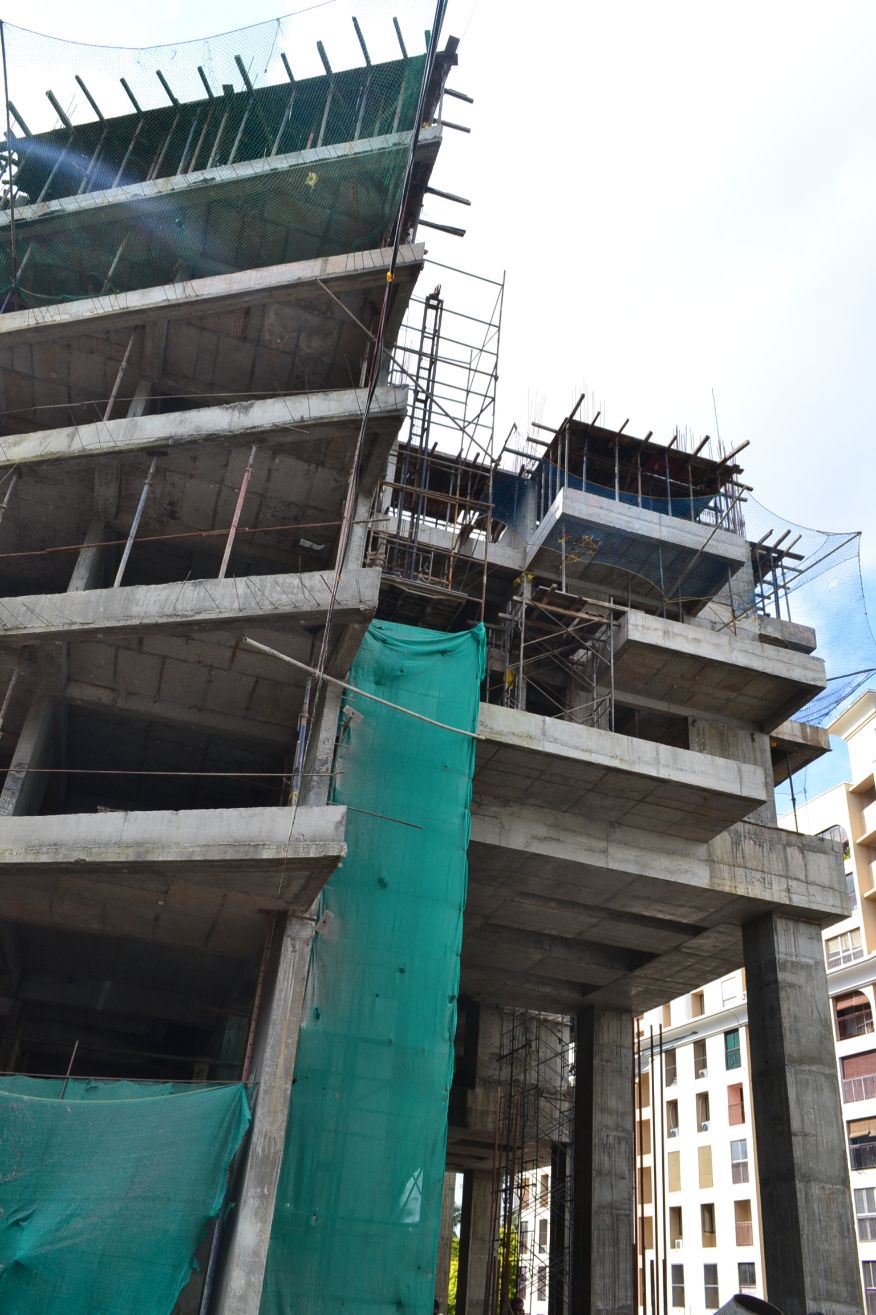

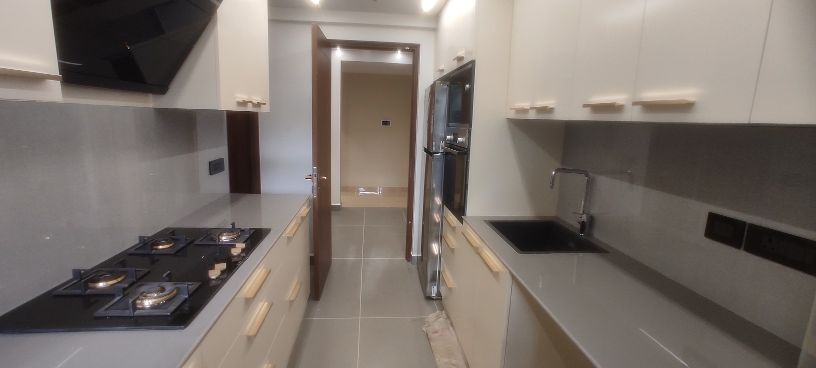

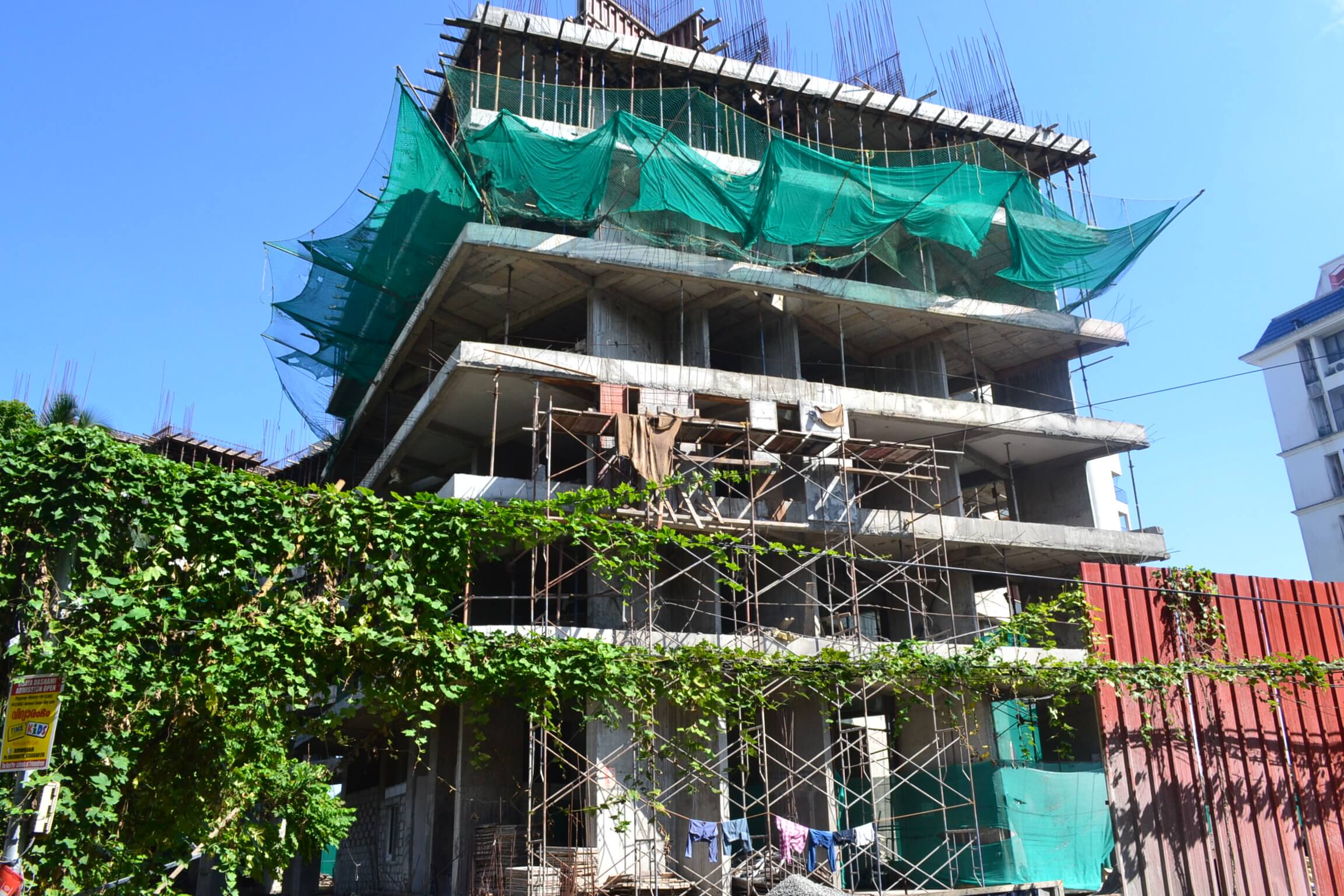

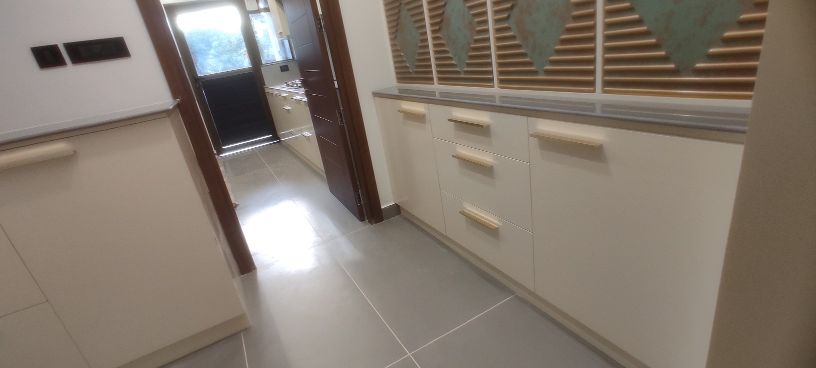

Work status as on 08-03-2023, we have completed the following.

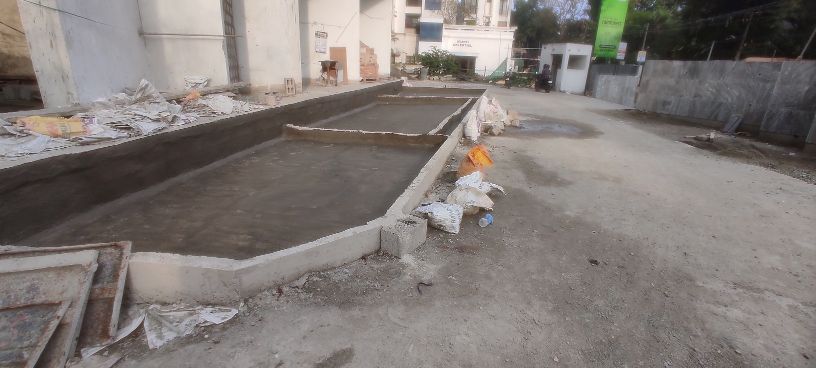

  • Structural Works – Swimming pool wall – 100% completed, basement 2 level parapet – 90% completed, Ground floor – 90% completed
  • Civil Works – Ceiling and wall plastering 85% completed, Masonry – Block/ brick- Basement 1 floor 100% completed, basement 2 floor – 75% completed, Ground floor – 50% completed

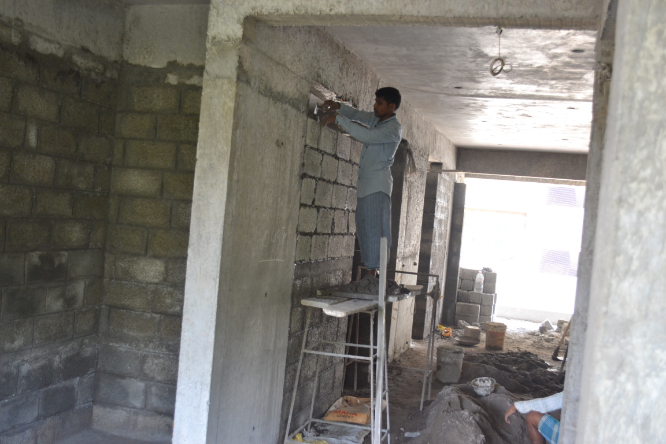

  • Internal Finishes – Main door – 42 apartments completed, Waterproofing – 15th floor – 75% completed, terrace – 25% completed, wall tiling – 43 apartments completed, flooring – 30 apartments completed, putty works – 100% completed, Door frame fixtures- 100% completed, Handrails – fire stair handrail – 50% Completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 72 nos: completed, Corridor handrail works – 90% completed, Centralised gas piping system – mockup only, fire fighting work – 2nd to 10th floor – 100% completed, Electrical LT work – wire pulling – 25 apartments completed, HT work – cable tray work started
  • External Finishes – Windows and sliding doors – mockup only, External plastering – 95% completed, External painting – primer 85% completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer 100% completed, HVAC -100% completed, Flooring – 100% completed, balcony handrail – 100% completed, duct door – 100% completed.

As per the current work status from our site, we are targeted to complete the following works by the end of MARCH 2023.

  • Structural Works – basement 2 level parapet – 100% to be completed, Ground floor – 100% to be completed
  • Civil Works – Masonry – Block/Brick – basement 2 floor – 100% to be completed, Ground floor – 100% to be completed
  • Internal Finishes – Maindoor – 56 more numbers to be fixed, Waterproofing – 15th floor 100% to be completed, terrace 50% to be completed, Flooring – 5 more apartments to be completed, Handrail – fire stair handrail – 100% to be completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 6nos: more to be completed, Electrical LT work – wire pulling 7 more apartments to be completed, fire fighting work – 1st floor – 100% to be completed
  • External Finishes – External plastering – 100% to be completed, Painting – primer 95% to be completed

Work status as on 11-02-2023, we have completed the following.

  • Structural Works – Swimming pool wall – 100% completed, basement 2 level parapet – 80% completed, Ground floor – 80% completed, OHT wall – 100% completed
  • Civil Works – Ceiling and wall plastering 85% completed, Masonry – Block/ brick- Basement 1 floor 100% completed, basement 2 floor – 50% completed, Ground floor – 50% completed
  • Internal Finishes – Main door – 42 apartments completed, Waterproofing – 13th, 14th floor 50% completed, basement 2 50% completed, wall tiling – 42 apartments completed, flooring – 20 apartments completed, putty works – 100% completed, Door frame fixtures- 100% completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 71 nos: completed, Centralised gas piping system – mockup only, fire fighting work – 2nd to 10th floor – 100% completed, Electrical LT work – wire pulling – 25 apartments completed, HT work – cable tray work started
  • External Finishes – Windows and sliding doors – mockup only, External plastering – 90% completed, External painting – primer 80% completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer 100% completed, HVAC -100% completed, Flooring – 100% completed, balcony handrail – 100% completed, duct door – 100% completed.

As per the current work status from our site, we are targeted to complete the following works by the end of FEBRUARY 2023.

  • Structural Works – basement 2 level parapet – 100% to be completed, Ground floor – 90% to be completed
  • Civil Works – Masonry – Block/Brick – basement 2 floor – 100% to be completed, Ground floor – 100% to be completed
  • Internal Finishes – Waterproofing – 13th floor 100% to be completed, 1st floor – 100% to be completed, basement 2 floor – 100% to be completed, Wall tiling – 1 more apartment to be completed, Flooring – 3 more apartments to be completed, Handrail -staircase handrail – 50% to be completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 6nos: more to be completed, Electrical LT work – wire pulling 7 more apartments to be completed, fire fighting work – 1st floor – 100% to be completed.
  • External Finishes – External plastering – 95% to be completed, Painting – primer 85% to be completed

Work status as on 14-01-2023, we have completed the following.

  • Structural Works – Swimming pool wall – 100% completed, basement 2 level parapet – 80% completed, Ground floor – 75% completed, OHT Slab – 100% completed
  • Civil Works – Ceiling and wall plastering 85% completed, Masonry – Block/ brick- Basement 1 floor 90% completed, basement 2 floor – 50% completed, Ground floor – 50% completed
  • Internal Finishes – Main door – 42 apartments completed, Waterproofing – 13th floor 50% completed, basement 2 50% completed, 1st – 50% completed, 2nd, 3rd floor – 100% completed, wall tiling – 42 apartments completed, flooring – 13 apartments completed, putty works – 95% completed, Door frame fixtures- 100% completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 49 nos: completed, Corridor handrail works -90% completed, Centralised gas piping system – mockup only, fire fighting work – 2nd to 10th floor – 100% completed, Electrical LT work – wire pulling – 15 apartments completed, HT work – cable tray work started
  • External Finishes – Windows and sliding doors – mockup only, External plastering – 90% completed, External painting – primer 80% completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer 100% completed, HVAC -100% completed, Flooring – 100% completed, balcony handrail – 100% completed, duct door – 100% completed.

As per the current work status from our site, we are targeted to complete the following works by the end of JANUARY 2023.

  • Structural Works – basement 2 level parapet – 100% to be completed, Ground floor – 100% to be completed, OHT wall – 100% to be completed
  • Civil Works – Masonry – Block/Brick – Basement 1 floor 100% to be completed, basement 2 floor – 75% to be completed, Ground floor – 100% to be completed
  • Internal Finishes – Waterproofing – 13th floor 100% to be completed, 1st floor – 100% to be completed, basement 2 floor – 100% to be completed, Wall tiling – 1 more apartment to be completed, putty works – 100% to be completed, Flooring – 3 more apartments to be completed, Handrail -staircase handrail – 50% to be completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 6nos: more to be completed, Electrical LT work – wire pulling 12 more apartments to be completed, fire fighting work – 1st floor – 100% to be completed
  • External Finishes – External plastering – 95% to be completed, Painting – primer 85% to be completed

Work status as on 13-12-2022, we have completed the following

As per the current work status from our site, we are targeted to complete the following works by the end of DECEMBER 2022.

  • Structural Works – basement 2 level parapet – 100% to be completed, Ground floor – 100% to be completed
  • Civil Works – wall plastering – 15th floor 100% to be completed, Masonry – Block/Brick – Basement 1 floor 100% to be completed, basement 2 floor – 75% to be completed, Ground floor – 50% to be completed
  • Internal Finishes – Main door – 20 apartments more to be fixed, Waterproofing – 12th floor 100% to be completed, 13th floor 50% to be completed, Wall tiling – 1st floor 100% to be completed, putty works – 15th floor 100% to be completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 6nos: more to be completed, Corridor handrail works – 13th, 14th, 15th floor 100% to be completed, Electrical LT work – wire pulling 12 more apartments to be completed
  • External Finishes – External plastering – 90% to be completed, Painting – primer 85% to be completed

Work status as on 13-12-2022, we have completed the following.

  • Structural Works – LMR – 100% completed, Swimming pool slab – 100% completed, basement 2 level parapet – 75% completed, Ground floor – 75% completed
  • Civil Works – Ceiling plastering – 15th floor 100% completed, wall plastering – 15th floor 90% completed, Masonry – Block/ brick- 15th floor 100% completed, Basement 1 floor 50% completed, basement 2 floor – 50% completed, Ground floor – 25% completed
  • Internal Finishes – Main door – 20 apartments completed, Waterproofing – 13th floor 50% completed, basement 2 50% completed, 1st, 2nd, 3rd floor – 50% completed, wall tiling – 42 apartments completed, flooring – 6 apartments completed, putty works – 95% completed, Door frame fixtures- 100% completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 43 nos: completed, Corridor handrail works -12th floor 100% completed, Centralised gas piping system – mockup only, fire fighting work – 10th floor – 100% completed, Electrical LT work – wire pulling – 6 apartments completed, HT work – cable tray work started
  • External Finishes – Windows and sliding doors – mockup only, External plastering – 80% completed, External painting – primer 80% completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer, putty, primer, 1 coat emulsion application completed, HVAC -100% completed, Flooring – 100% completed, balcony handrail – 100% completed, duct door – 100% completed.

As per the current work status from our site, we are targeted to complete the following works by the end of NOVEMBER 2022.

    • Structural Works – swimming pool – 75% to be completed, basement 2 level parapet – 100% to be completed
    • Civil Works – wall plastering – 15th floor 100% to be completed, Masonry – Block/Brick – Basement 1 floor 100% to be completed
    • Internal Finishes – Main door – 15 apartments more to be fixed, Waterproofing – 12th floor 100% to be completed, 13th floor 50% to be completed, Wall tiling – 1st floor 100% to be completed, putty works – 15th floor 100% to be completed.

Electrical, Plumbing & Firefighting works – Concealed plumbing works – 2nd, 1st floor 100% to be completed, Corridor handrail works – 13th, 14th, 15th floor 100% to be completed, Fire fighting work – 10th floor 100% to be completed, Electrical LT work – wire pulling 6 more apartments to be completed

  • External Finishes – External plastering – 90% to be completed, Painting – primer 85% to be completed

Work status as on 15-11-2022, we have completed the following.

  • Structural Works – Pile cap – 100% completed, slab completed – 16th Floor 100% completed, LMR – 100% completed, Swimming pool – 40% completed, basement 1 level parapet – 100% completed, basement 2 level parapet – 75% completed.
  • Civil Works – Ceiling plastering – 15th floor 100% completed, wall plastering – 15th floor 90% completed, Masonry – Block/ brick- 15th floor 100% completed, Basement 1 floor 50% completed.
  • Internal Finishes – Main door – 13 apartments completed, Waterproofing – 12th floor 50% completed, basement 1 floor 100% completed, basement 2 50% completed, wall tiling – 2nd, 3rd, 8th floor 100% completed, flooring – mock up only, putty works – 14th floor – 100% completed, Door frame fixtures-15th floor 100% completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 8th floor 100% completed, Corridor handrail works -12th floor 100% completed, Centralised gas piping system – mockup only, fire fighting work – 9th floor – 100% completed, Electrical LT work – upto 15th floor 100% completed, wire pulling – 3 apartments completed, HT work – cable tray work started
  • External Finishes – Windows and sliding doors – mockup only, External plastering – 80% completed, External painting – primer 80% completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer, putty, primer, 1 coat emulsion application completed, HVAC -100% completed, Flooring – 100% completed, balcony handrail – 100% completed, duct door – 100% completed.

Work status as on 11-10-2022, we have completed the following.

  • Structural Works – Pile cap – 100% completed, slab completed – 16th Floor 100% completed, LMR – 75% completed, Swimming pool – 40% completed, basement 1 level parapet – 100% completed, basement 2 level parapet – 50% completed.
  • Civil Works – Ceiling plastering – 15th floor 90% completed, wall plastering – 14th floor 100% completed, Masonry – Block/ brick- 15th floor 100% completed
  • Internal Finishes – Main door – 5 apartments completed, Waterproofing – 10th floor 90% completed, 11th floor 90% completed, wall tiling – 8th floor 80% completed, 3rd floor – 75% completed, flooring – mock up only, putty works – 14th floor – 100% completed, Door frame fixtures-15th floor 100% completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 8th floor 100% completed, Corridor handrail works -12th floor 100% completed, Centralised gas piping system – mockup only, fire fighting work – 8th floor – 100% completed, Electrical LT work – upto 14th floor 100% completed, HT work – cable tray work started
  • External Finishes – Windows and sliding doors – mockup only, External plastering – 80% completed, External painting – primer 80% completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer, putty, primer, 1 coat emulsion application completed, HVAC -100% completed, Flooring – 100% completed, balcony handrail – 100% completed, duct door – 100% completed.

As per the current work status from our site, we are targeted to complete the following works by the end of OCTOBER 2022.

  • Structural Works – LMR – 100% to be completed, swimming pool – 75% to be completed, basement 2 level parapet – 100% to be completed
  • Civil Works – Ceiling plastering – 15th Floor 100% to be completed, wall plastering – 15th floor 100% to be completed
  • Internal Finishes – Main door – 15 apartments more to be fixed, Waterproofing – 12th floor 100% to be completed, Wall tiling – 1st & 2nd, 3rd, 8th floor – 100% to be completed, putty works – 15th floor 100% to be completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 2nd, 1st floor 100% to be completed, Corridor handrail works – 13th, 14th, 15th floor 100% to be completed, Fire fighting work – 9th floor 100% to be completed, Electrical LT work – up to 15th floor to be completed
  • External Finishes – External plastering – 90% to be completed, Painting – primer 85% to be completed

Work status as on 17-09-2022, we have completed the following.

  • Structural Works – Pile cap – 100% completed, slab completed – 16th Floor 100% completed, LMR – 50% completed, Swimming pool – 40% completed
  • Civil Works – Ceiling plastering – 15th floor 85% completed, wall plastering – 14th floor completed, Masonry – Block/ brick- 15th floor 100% completed
  • Internal Finishes – Main door – MOCKUP only, Waterproofing – 10th floor 90% completed, 11th floor 75% completed, wall tiling – 5th floor 60% completed, 3rd floor – 30% completed, flooring – mock up only, putty works – 13th floor 70% completed, 14th floor – 100% completed, Door frame fixtures-14th floor 100% completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 7th floor 100% completed, Corridor handrail works -12th floor 100% completed, Centralised gas piping system – mockup only, fire fighting work – 3rd to 7th floor – 100% completed, Electrical LT work – upto 14th floor 100% completed, HT work – cable tray work started
  • External Finishes – External plastering – 75% completed, External painting – primer 50% completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer, putty, primer, 1 coat emulsion application completed, HVAC -100% completed, Flooring – 100% completed

As per the current work status from our site, we are targeted to complete the following works by the end of SEPTEMBER 2022.

  • Structural Works – LMR – 100% to be completed, swimming pool – 75% to be completed, basement 1 level parapet – 100% to be completed
  • Civil Works – Ceiling plastering – 15th Floor 100% to be completed, wall plastering – 15th floor 100% to be completed
  • Internal Finishes – Main door – 10 apartments more to be fixed, Waterproofing – 10th,11th floor 100% to be completed, Wall tiling – 5th floor 100% to be completed, 3rd floor – 100% to be completed, putty works – 15th floor 100% to be completed, Door frame fixtures – 15th floor 100% to be completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 3rd floor 100% to be completed, Corridor handrail works – 13th, 14th, 15th floor 100% to be completed, Fire fighting work – 8th floor 100% to be completed, Electrical LT work – up to 15th floor to be completed
  • External Finishes – External plastering – 85% to be completed, Painting – primer 75% to be completed.

Work status as on 09-07-2022, we have completed the following.

  • Structural Works – All Sub-Structural and Structural work 98% Completed. GF north side drive way – 50% completed
  • Civil Works – Ceiling plastering and wall plastering- Inside flat 100% completed, Masonry – Block/ brick- inside flat area completed , Screeding – 45% (till 10th floor – 100% completed).
  • Internal Finishes – Main door – frame only -100% completed, Waterproofing up to 13th floor completed, (lift well -2, rainwater harvesting tank outside completed), Wall tiles – up to 11th floor completed, Floor Tiling up to 10th floor inside flat area completed, putty works & inside painting works – 72% completed (2nd coat putty completed, 1 coat primer completed), Handrails – 87% completed (main stair – till 14 th floor completed , fire stair – till 14 th floor completed, balcony handrail – till 19th floor completed).
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works- up to 13th floor, 18th floor completed, Fire fighting works – (2nd, 3rd, 5th, 6th floor – 70% completed) 20% completed
  • External Finishes – Windows and sliding door – mockup only, External Plastering – Elevation 2 (100%) & 3 (97%)Completed, Elevation 1 – 90% completed, Elevation 4 completed, External painting – Elevation 1 Damp proof – 90% completed, first coat putty work – 70% completed, elevation 2 – damp proof – 80% completed, 1st coat putty 65% completed, elevation 3 – damp proof -50% completed, 1st coat putty – 50% completed, elevation 4 – dramp proof & 1st coat putty completed
  • Mockup – Completed.

As per the current work status from our site, we are targeted to complete the following works by the end of JULY 2022.

  • Structural Works – All Sub-Structural and Structural work 98% Completed. GF north side drive way – 50% completed
  • Civil Works – Ceiling plastering and wall plastering- Inside flat 100% completed, Masonry – Block/ brick- inside flat area completed , Screeding – 45% (till 10th floor – 100% completed).
  • Internal Finishes – Main door – frame only -100% completed, Waterproofing up to 13th floor completed, (lift well -2, rainwater harvesting tank outside completed), Wall tiles – up to 11th floor completed, Floor Tiling up to 10th floor inside flat area completed, putty works & inside painting works – 72% completed (2nd coat putty completed, 1 coat primer completed), Handrails – 87% completed (main stair – till 14 th floor completed , fire stair – till 14 th floor completed, balcony handrail – till 19th floor completed).
  • Electrical, Plumbing & Firefighting works -Concealed plumbing works- up to 13th floor, 18th floor completed, Fire fighting works – (2nd, 3rd, 5th, 6th floor – 70% completed) 20% completed
  • External Finishes – Windows and sliding door – mockup only, External Plastering – Elevation 2 (100%) & 3 (97%)Completed, Elevation 1 – 90% completed, Elevation 4 completed, External painting – Elevation 1 Damp proof – 90% completed, first coat putty work – 70% completed, elevation 2 – damp proof – 80% completed, 1st coat putty 65% completed, elevation 3 – damp proof -50% completed, 1st coat putty – 50% completed, elevation 4 – dramp proof & 1st coat putty completed
  • Mockup – Completed.

Work status as on 09-06-2022, we have completed the following.

  • Structural Works – Pile cap – 99% completed, slab completed – 16th Floor 100% completed
  • Civil Works – Ceiling plastering- Basement 2 – 100% completed, 15th floor 70% completed, wall plastering- 13th floor 50% completed, Masonry – Block/ brick- 14th floor 100% completed
  • Internal Finishes – Main door – MOCKUP only, Waterproofing- 9th floor 50% completed, 10th floor – 50% completed, wall tiling – mockup only, flooring – mock up only, putty works – 12th floor 20% completed, Door frame fixtures-14th floor 100% completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works- 6th floor 75% completed, Corridor handrail works -12th floor 100% completed
  • External Finishes – External plastering – 50% completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – Primer application completed, HVAC -50% completed, Toilet tile work-90% completed

As per the current work status from our site, we are targeted to complete the following works by the end of JUNE 2022.

  • Structural Works – Pile cap – 100% to be completed
  • Civil Works – Ceiling plastering-15th Floor 100% to be completed, wall plastering – 13th floor 100% to be completed, Masonry – Block/ brick- 15th floor 100% to be completed
  • Internal Finishes – Waterproofing – 9th floor, 10th floor 100% to be completed, putty works- 12th floor 100% to be completed
  • Electrical, Plumbing & Firefighting works -Concealed plumbing works – 7th floor 100% to be completed, Corridor handrail works – 13 floor 100% to be completed
  • External Finishes – External plastering – 75% to be completed

Work status as on 12-04-2022, we have completed the following.

  • Structural Works – Entire structure is completed
  • Civil Works – Ceiling plastering- Basement 2 – 50% completed, 14th floor 100% completed, , wall plastering- 11th floor 70% completed, Masonry – Block/ brick- 14th floor 90% completed
  • Internal Finishes – Main door – MOCKUP only, Waterproofing- 8th floor 50% completed, putty works – 8th floor 100% completed, Door frame fixtures-13th floor 100% completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works- 4th floor, 5th floor 90% completed, Corridor handrail works -12th floor 100% completed.
  • External Finishes – External plastering – 30% completed.
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – Primer application completed, HVAC -50% completed, Toilet tile work-90% completed.

As per the current work status from our site, we are targeted to complete the following works by the end of APRIL 2022.

  • Civil Works – Ceiling plastering-15th Floor 100% to be completed, wall plastering-11th floor 100% to be completed, 12th floor – 30% to be completed, Masonry – Block/ brick- 14th floor 100% to be completed
  • Internal Finishes – Waterproofing-8th floor 100% to be completed, putty works- 9th floor 50% to be completed, Door frame fixtures- 14th floor 100% to be completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works- 4th, 5th floor – 100% to be completed, 6th floor – 50% to be completed, Corridor handrail works -13 floor 100% to be completed.
  • External Finishes – External plastering – 50% to be completed.

Work status as on 10-03-2022, we have completed the following.

  • Structural Works – Pile cap – 99% completed, slab completed – 16th Floor 80% completed
  • Civil Works – Ceiling plastering-14th floor100% completed, wall plastering- 11th floor 30% completed, Masonry – Block/ brick- 14th floor 60% completed
  • Internal Finishes – Main door – MOCKUP only, Waterproofing- 7th floor 100% completed, putty works – 6th floor 100% completed, Door frame fixtures-12th floor 100% completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works- 13% completed, Corridor handrail works -11th floor 100% completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – Primer application completed, HVAC -50% completed, Toilet tile work-90% completed

As per the current work status from our site, we are targeted to complete the following works by the end of MARCH 2022.

  • Structural Works – Pile cap – 100% to be completed, slab – 16th floor100% to be completed
  • Civil Works – Ceiling plastering-15th Floor 100% to be completed, wall plastering-11th floor 100% to be completed, 12th floor – 30% to be completed, Masonry – Block/ brick- 14th floor 100% to be completed
  • Internal Finishes – Waterproofing-8th floor 100% to be completed, putty works- 7th floor 100% to be completed, Door frame fixtures- 13th floor 100% to be completed, 14th floor 100% to be completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works- 20% to be completed, Corridor handrail works -12 floor 100% to be completed

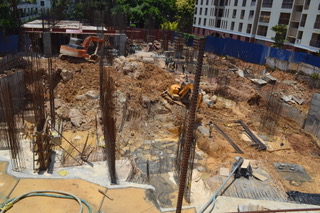

Work status as on 09-04-2021, we have completed the following.

    • Earthwork – 90% completed
    • Pile chipping work – completed
    • Pile cap work -92% completed
    • RCC for slab
      • BF2-11th floor slab -RCC work -100% completed
    • Column work :
      • BF2 – 10 th floor -100% completed ,11th floor -50% completed.
    • RCC for Ramp
      • BF2- 80% completed, BF1- 90% completed
    • Ceiling Plastering
      • 1st floor:- 70% completed
      • Ceiling Plastering (2nd floor-9th floor ):90% completed
    • Electrical wall chasing
      • 2nd floor – 20% completed,3rd floor-70% completed,4th floor-80% completed.
    • wall plastering
      • 2nd floor – 20% completed.
    • Blockwork
      • 1st floor-50% completed ,2ndfloor -75% completed, 3rd-5th floor -90% completed,6th floor – 25% completed.

As per the current work status from our site, we are targeted to complete the following works by the end of APRIL 2021.

        • RCC for slab
          • 12th floor-75% to be completed
        • Column work :
          • 11th floor – 100% to be completed
          • 12th floor-20% to be completed.
        • Rcc for Retaining wall
          • Base floor2-25% to be completed.
        • RCC for Ramp
          • Ceiling – 1st floor:- 90% to be completed
        • Electrical wall chasing
          • 2nd floor – 25% to be completed
        • Blockwork
          • 6th floor:-90% to be completed, 7th floor-30% to be completed.

Work status as on 11-03-2021, we have completed the following.

Tower 1

            • Internal wall plastering work -up to 18th floor -100% completed, Roof-75% completed.
            • Dadoing of toilets: up to 15th floor -100% completed.
            • Dadoing of kitchen walls :GF – 50% completed,1st floor-13th floor-100% completed,
            • Wire pulling : GF -30%,1st and 3 rd,5 th ,7 th  -90%,2,4,8th -25% completed,6th,9th-15th floor-100% completed,16th floor- 50% completed.
            • Water Proofing work – Upto 18th floor- 100% completed,terrace -75% completed

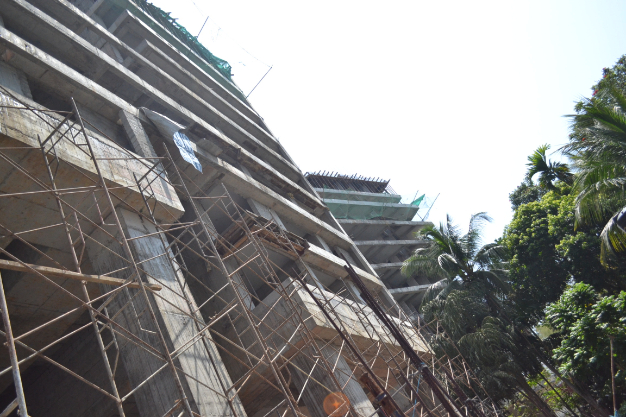

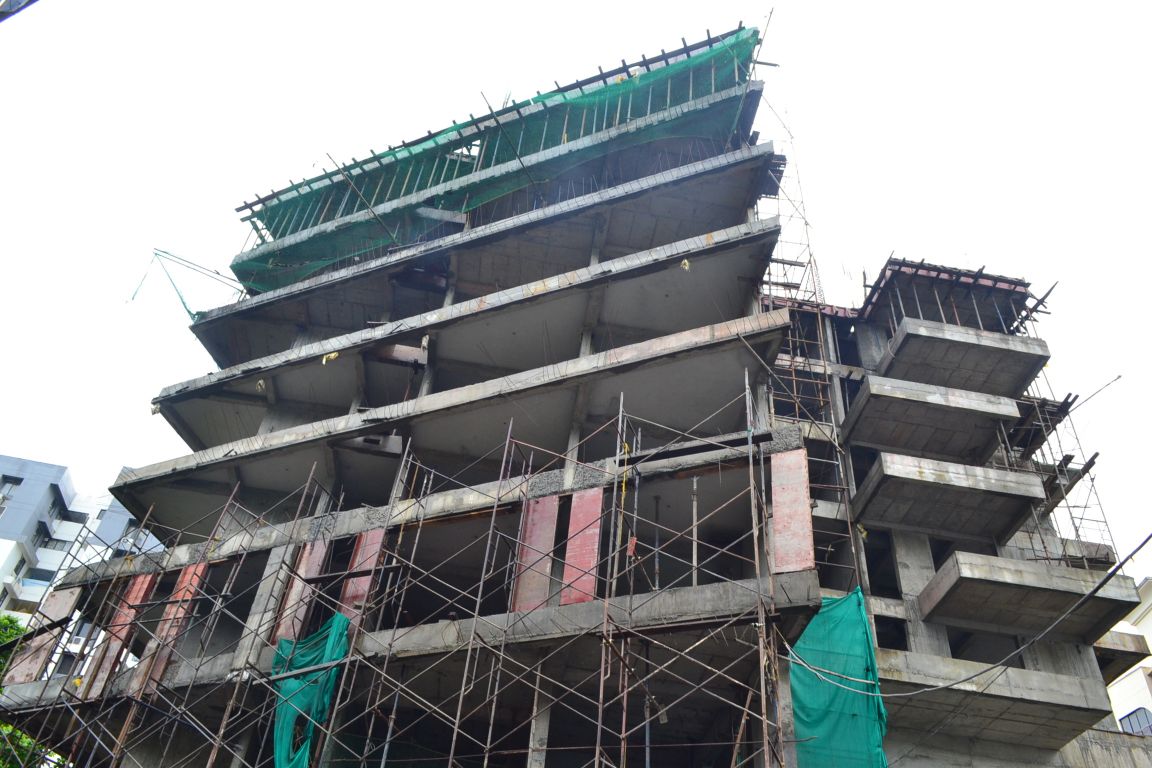

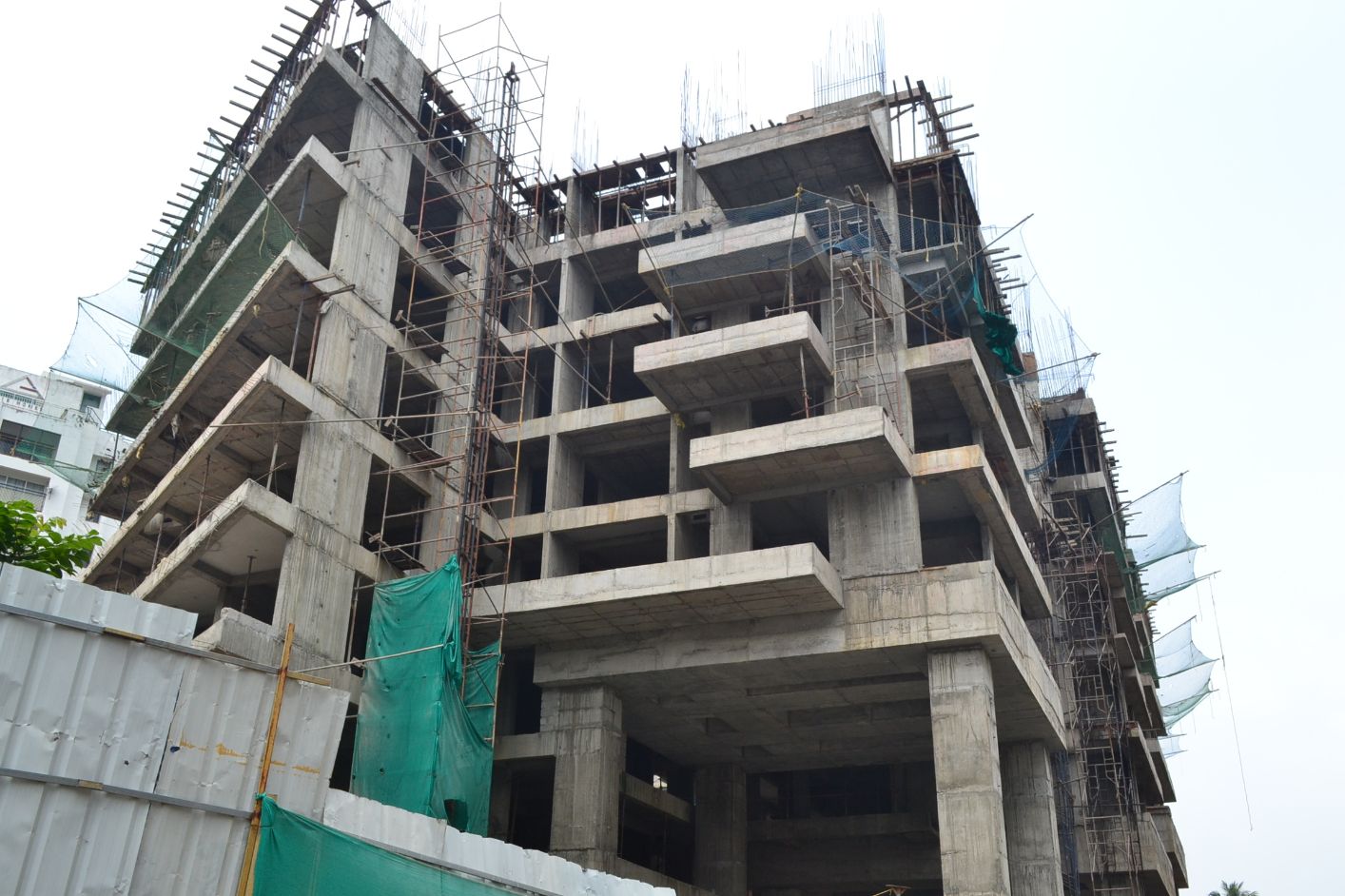

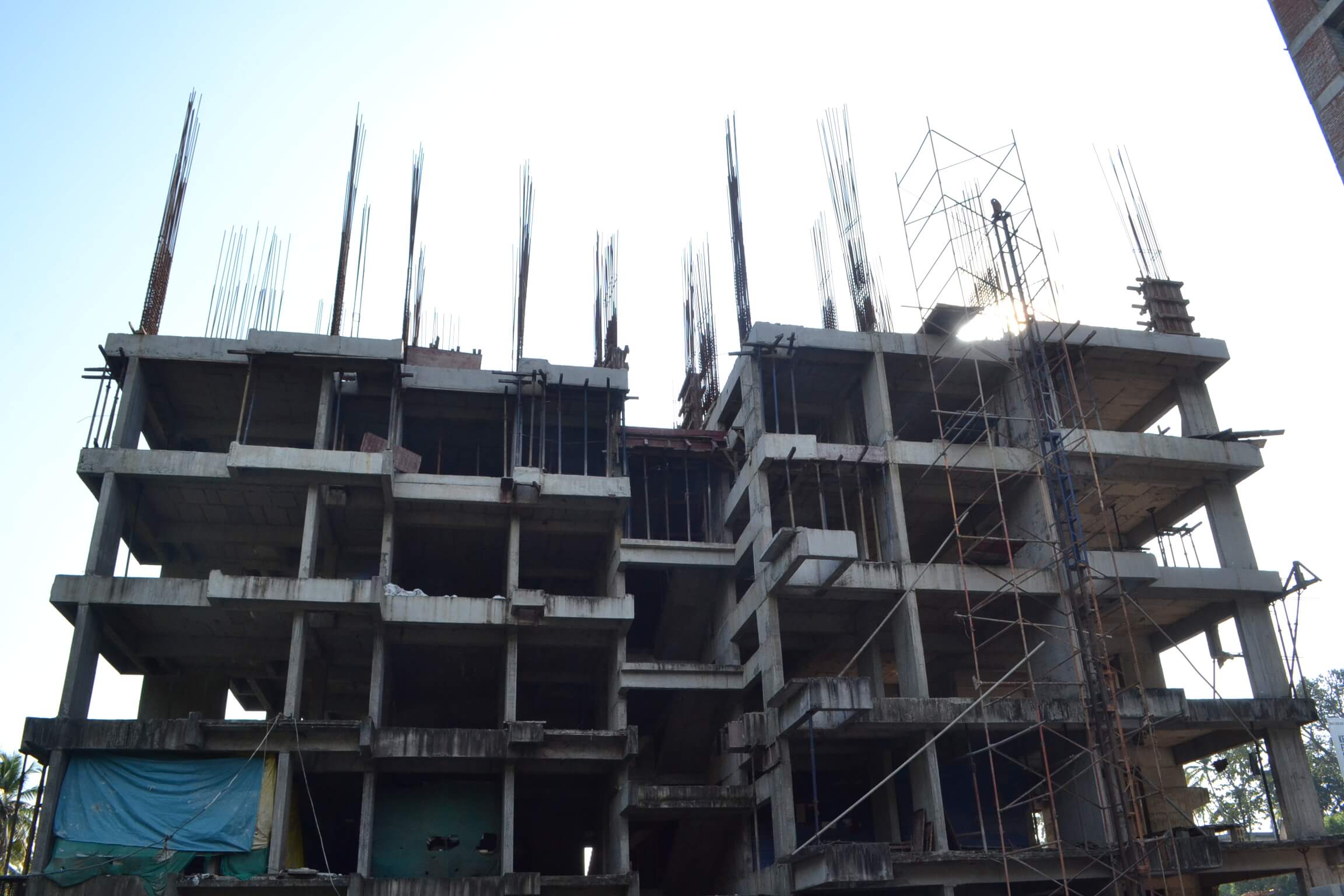

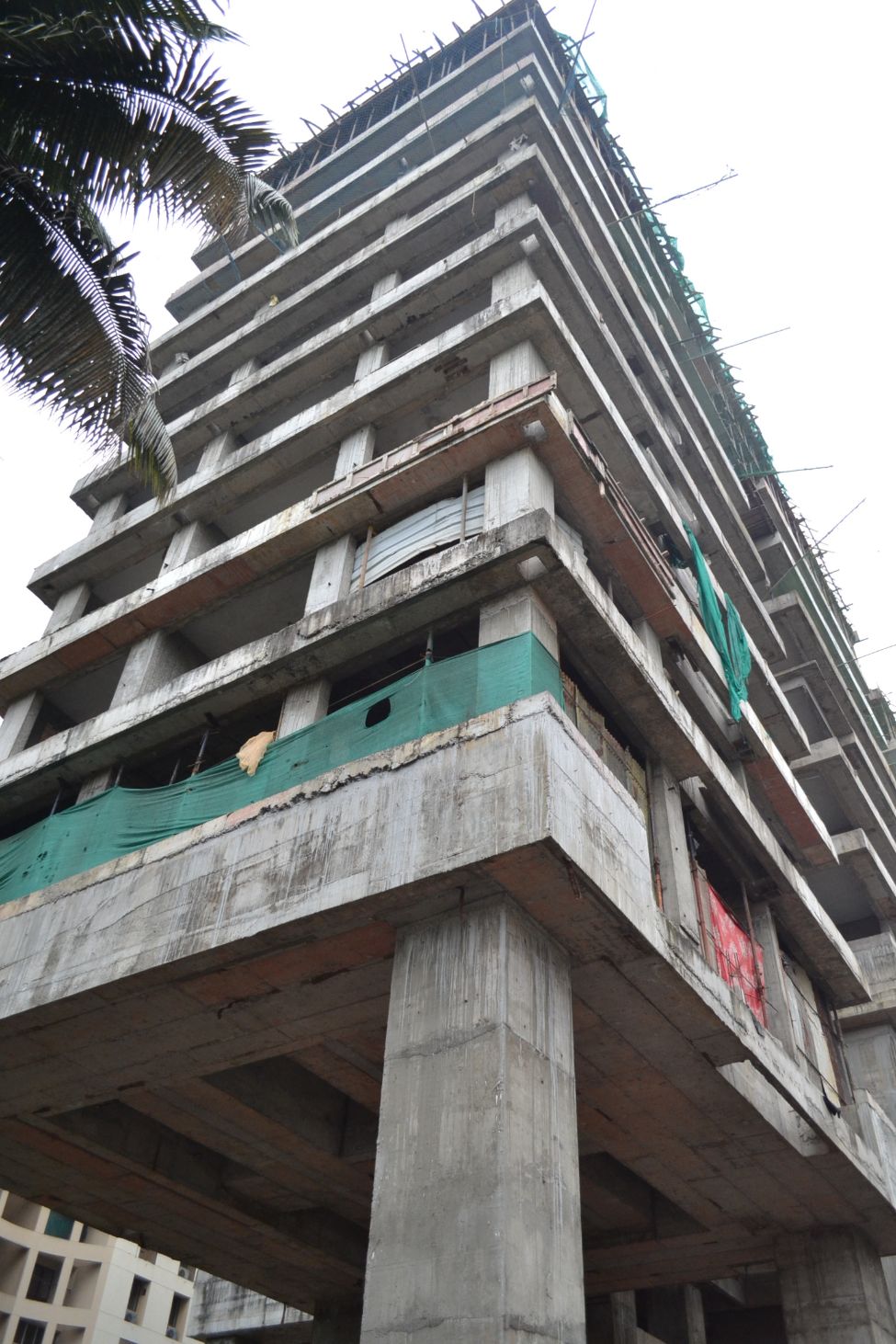

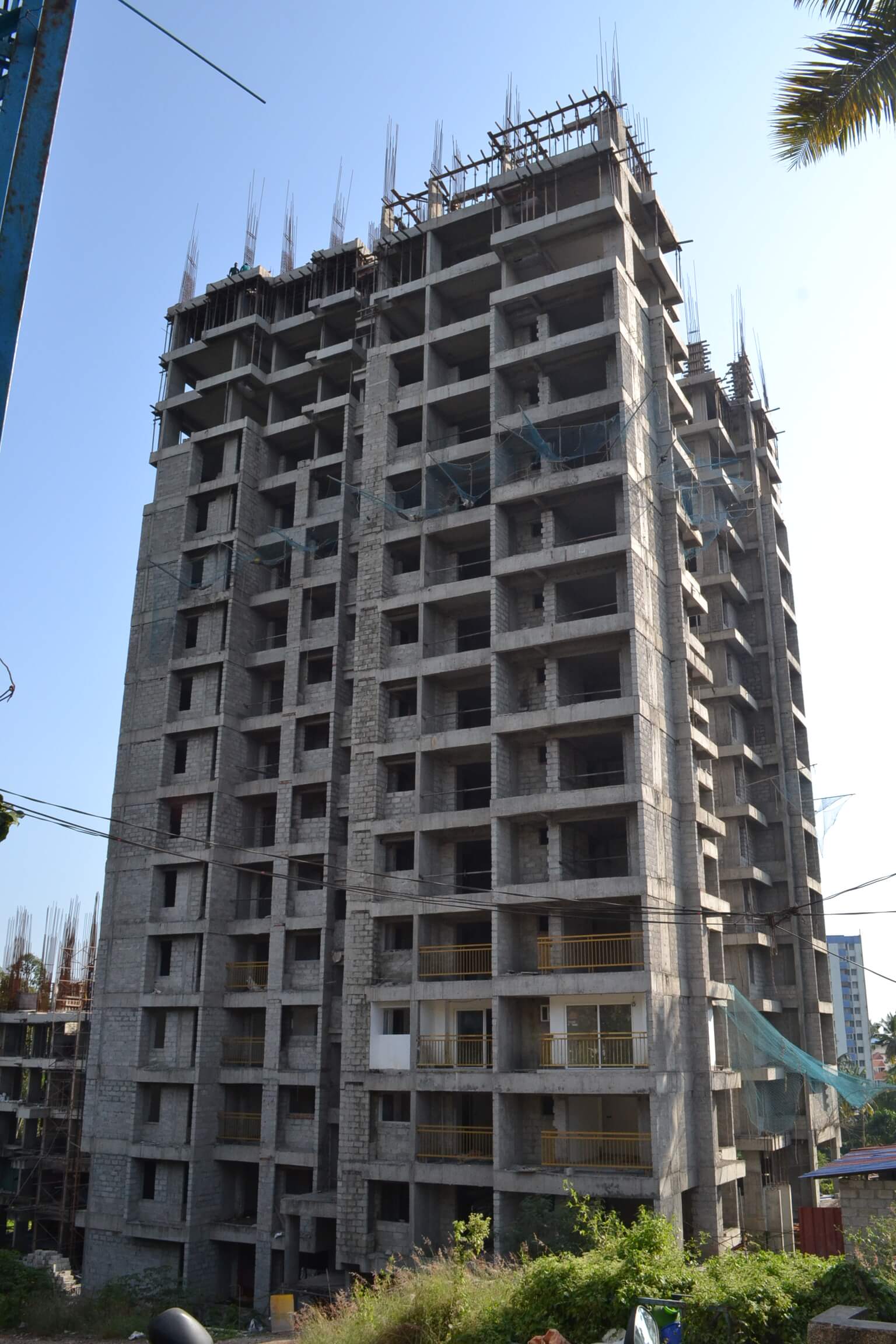

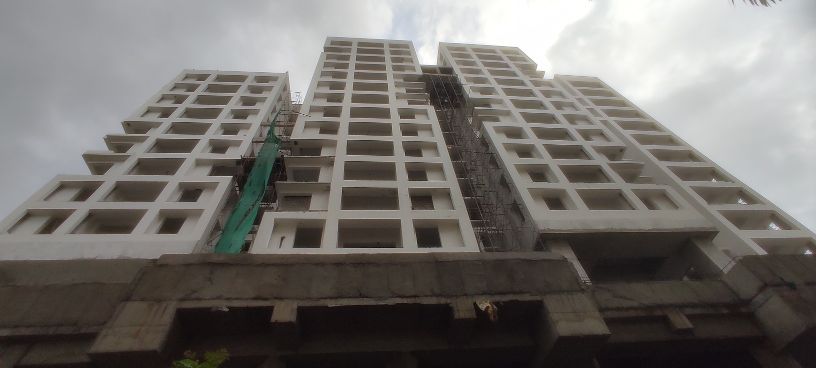

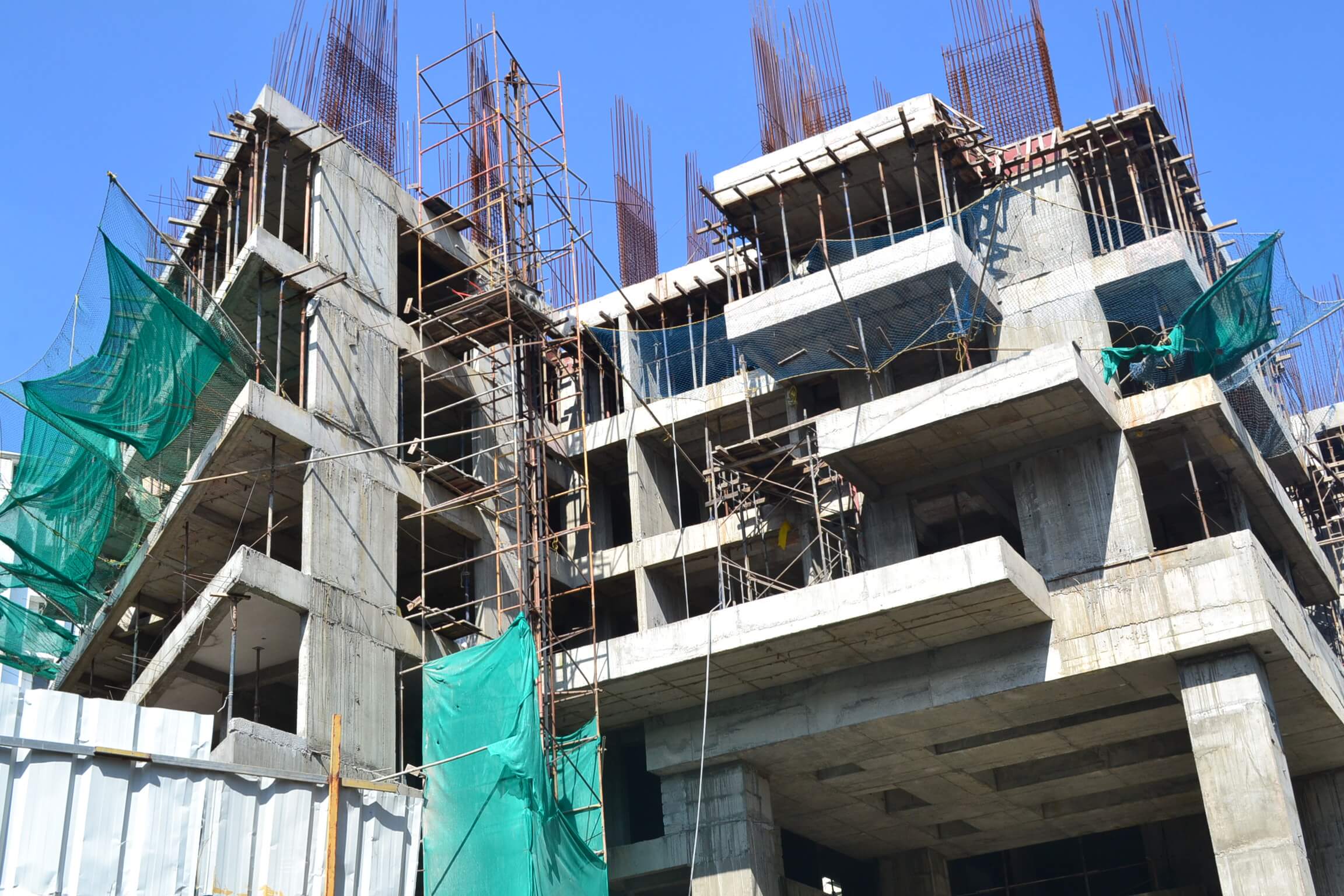

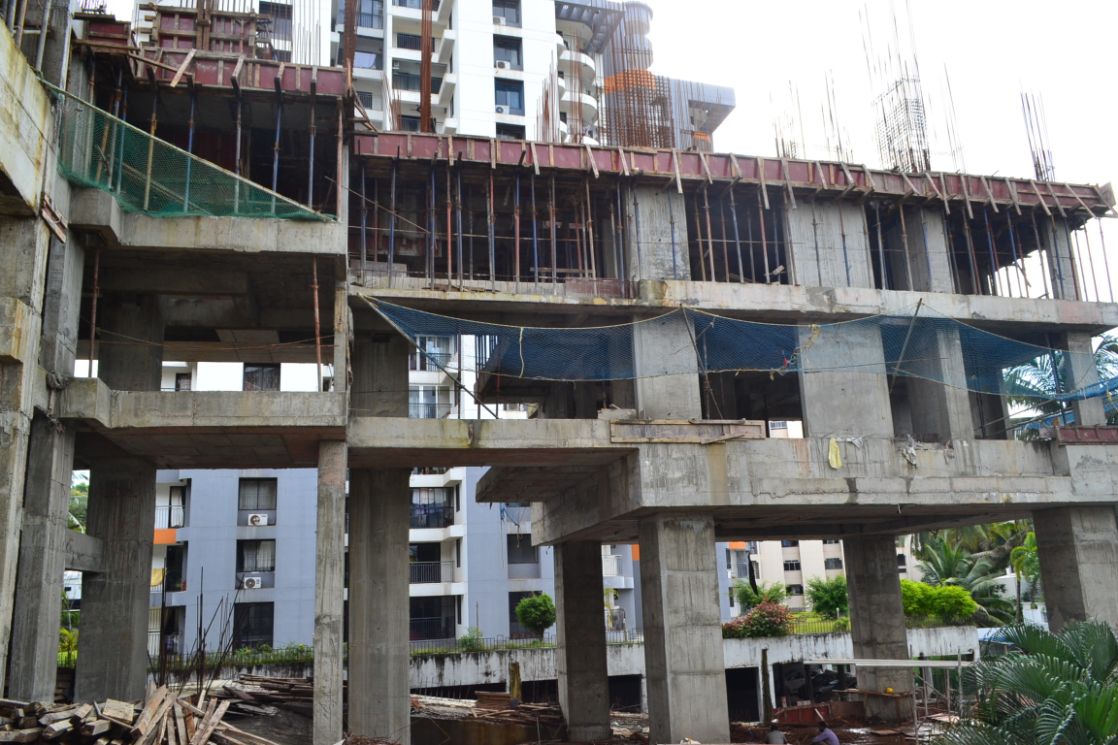

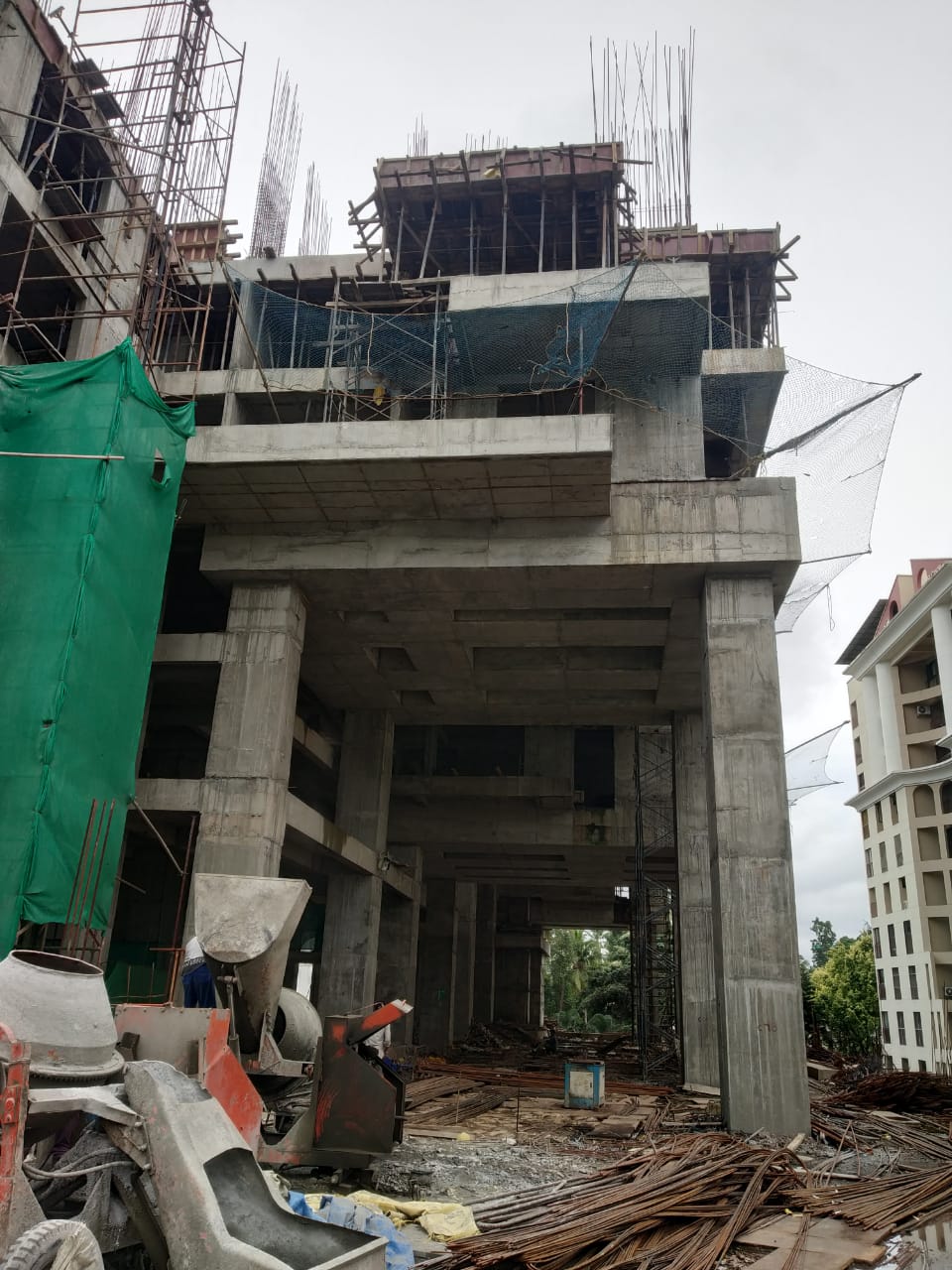

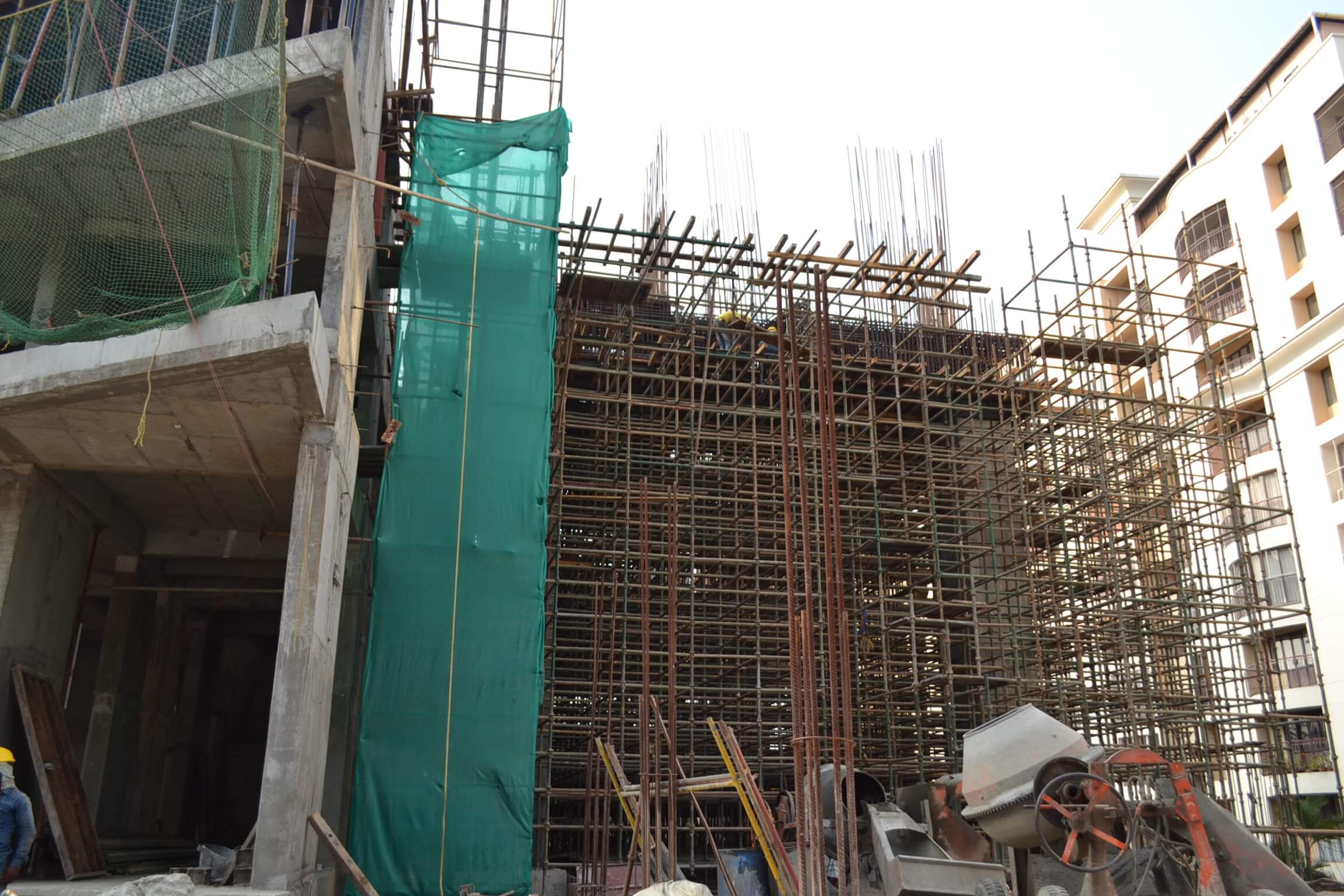

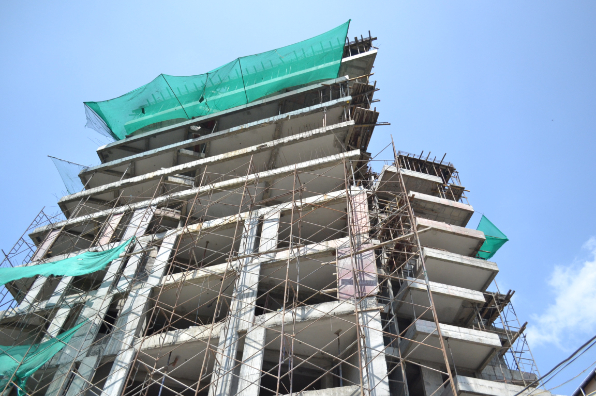

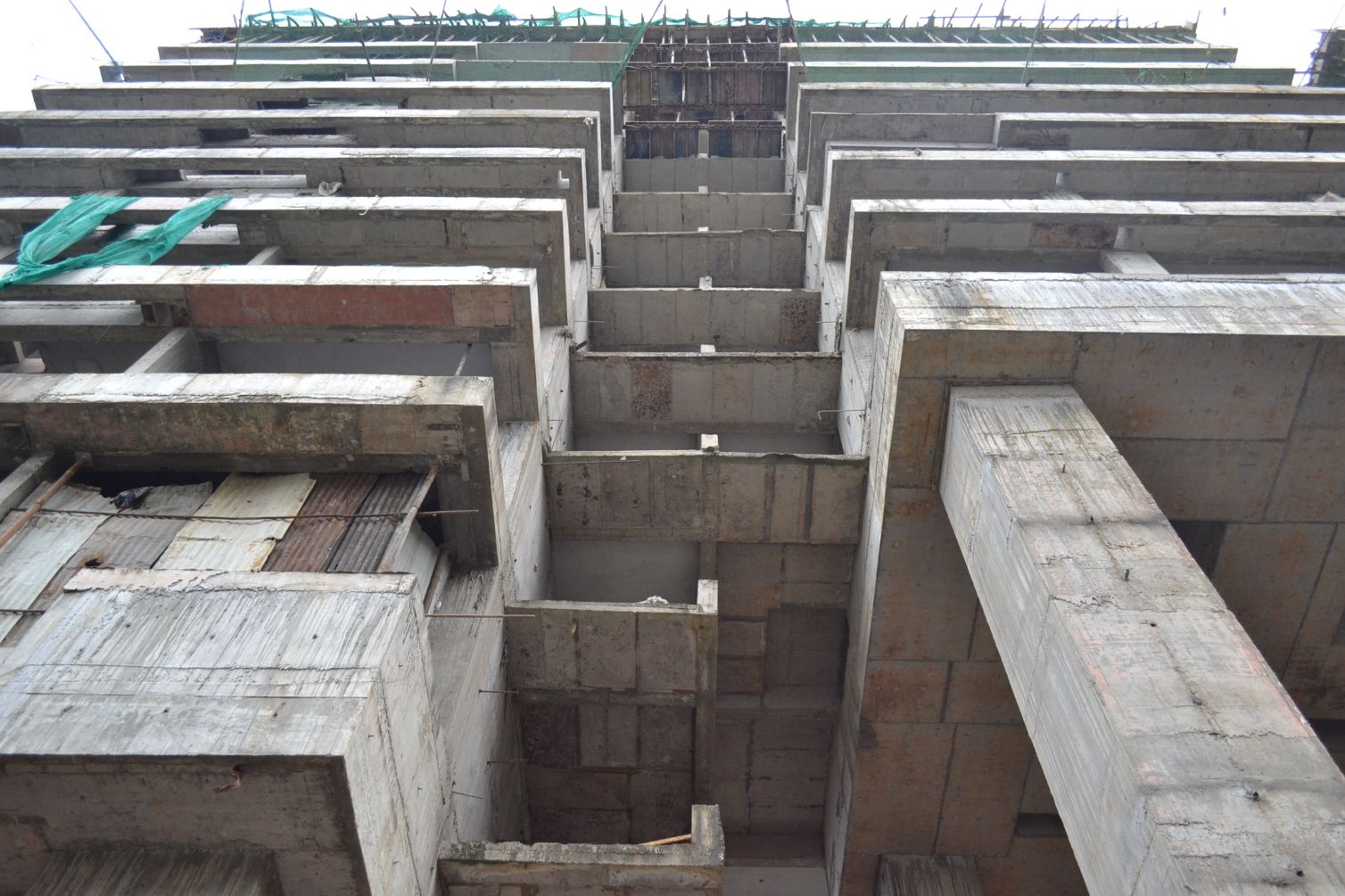

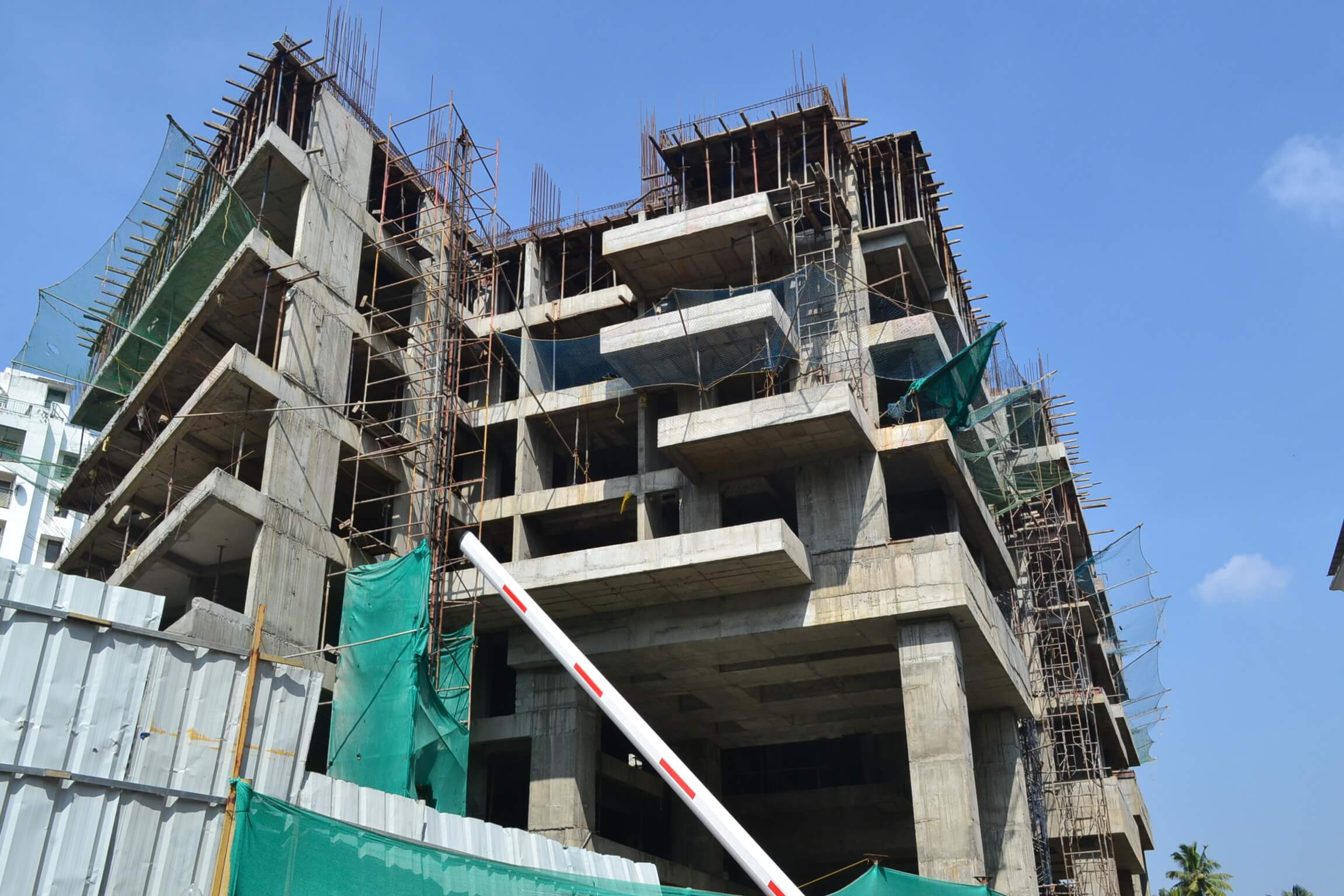

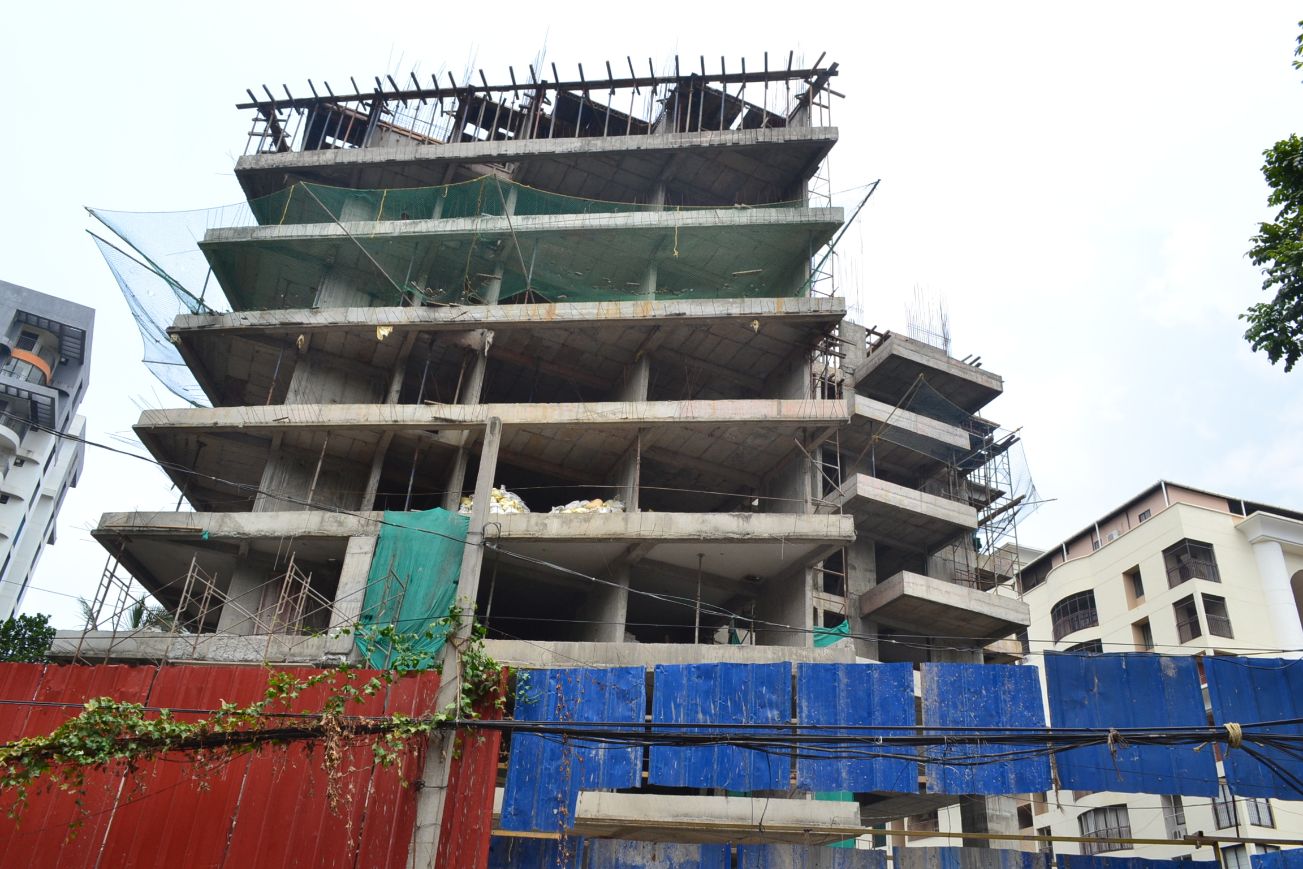

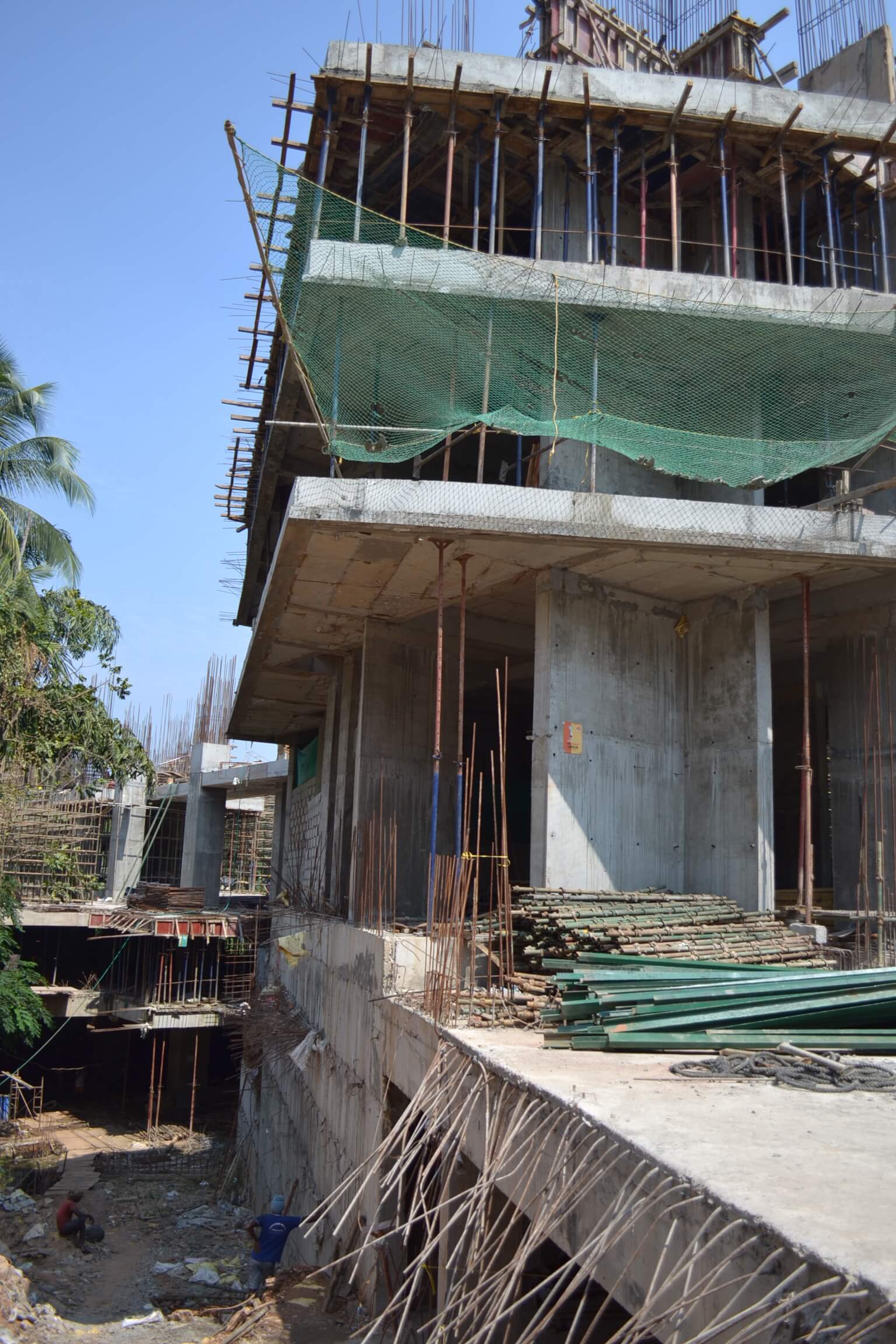

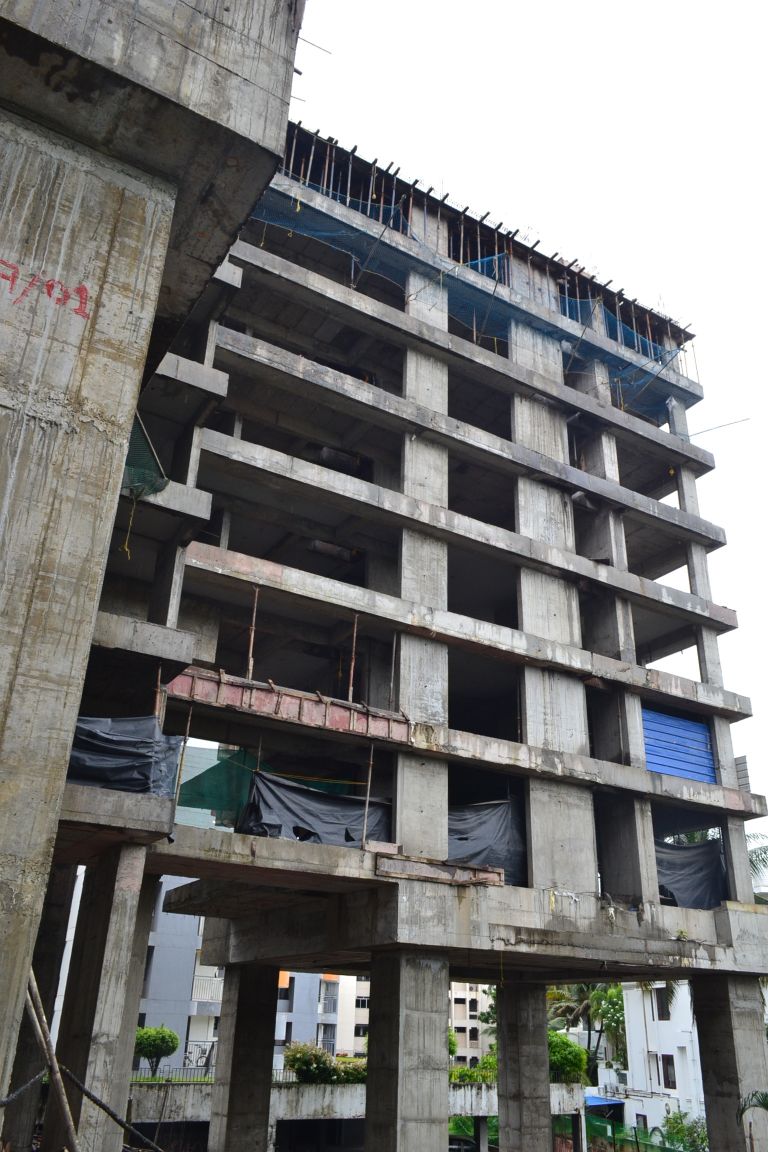

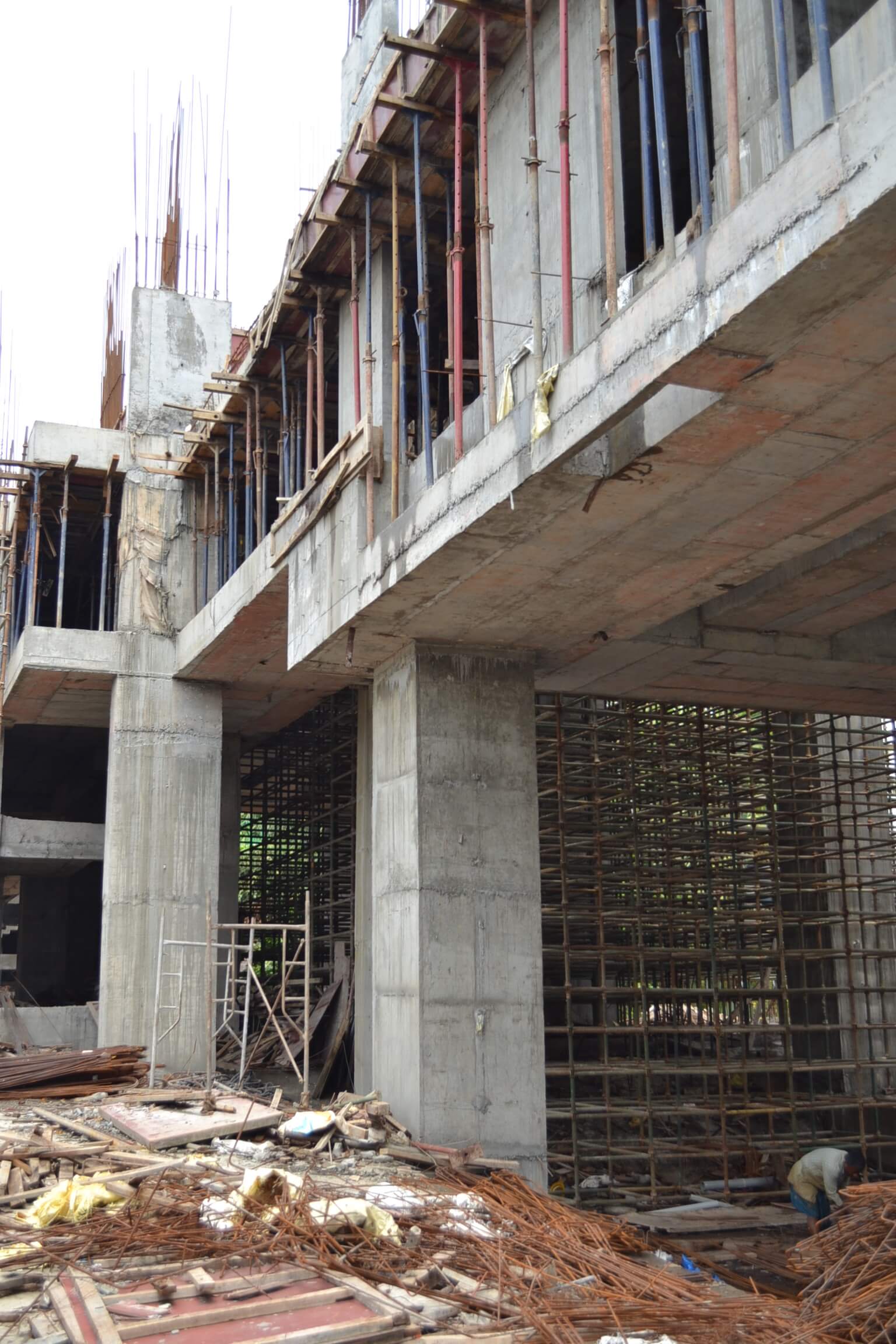

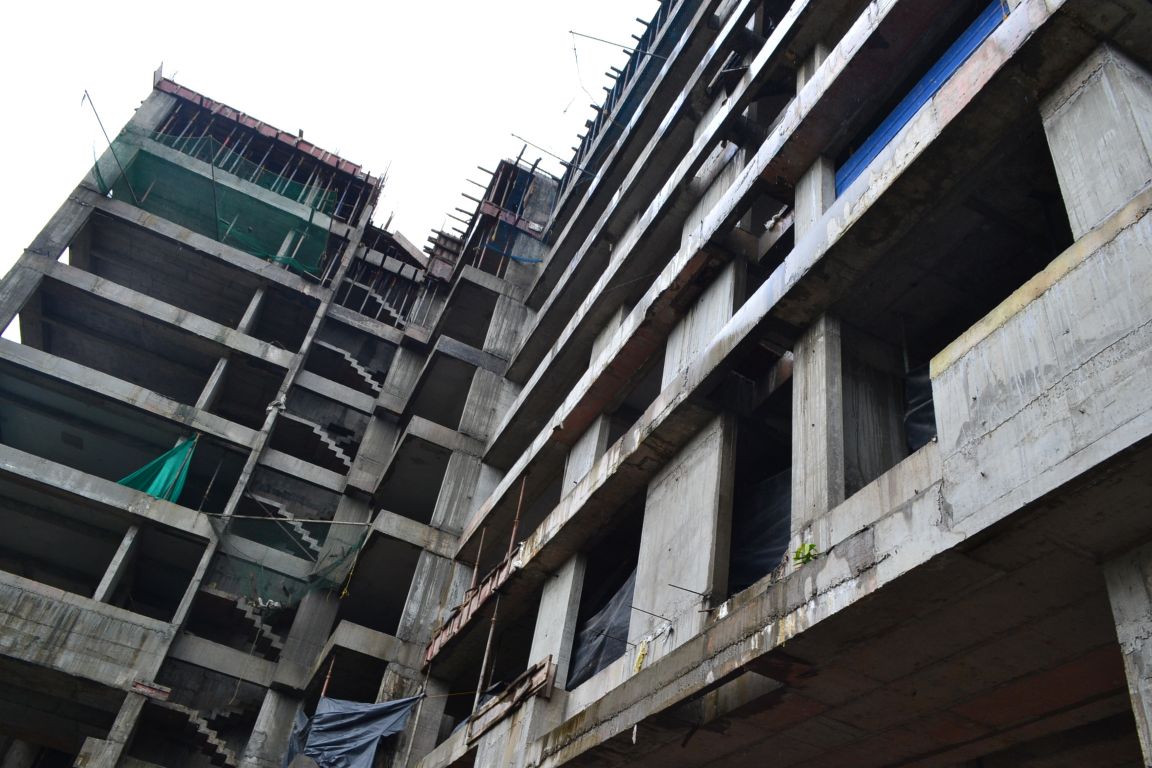

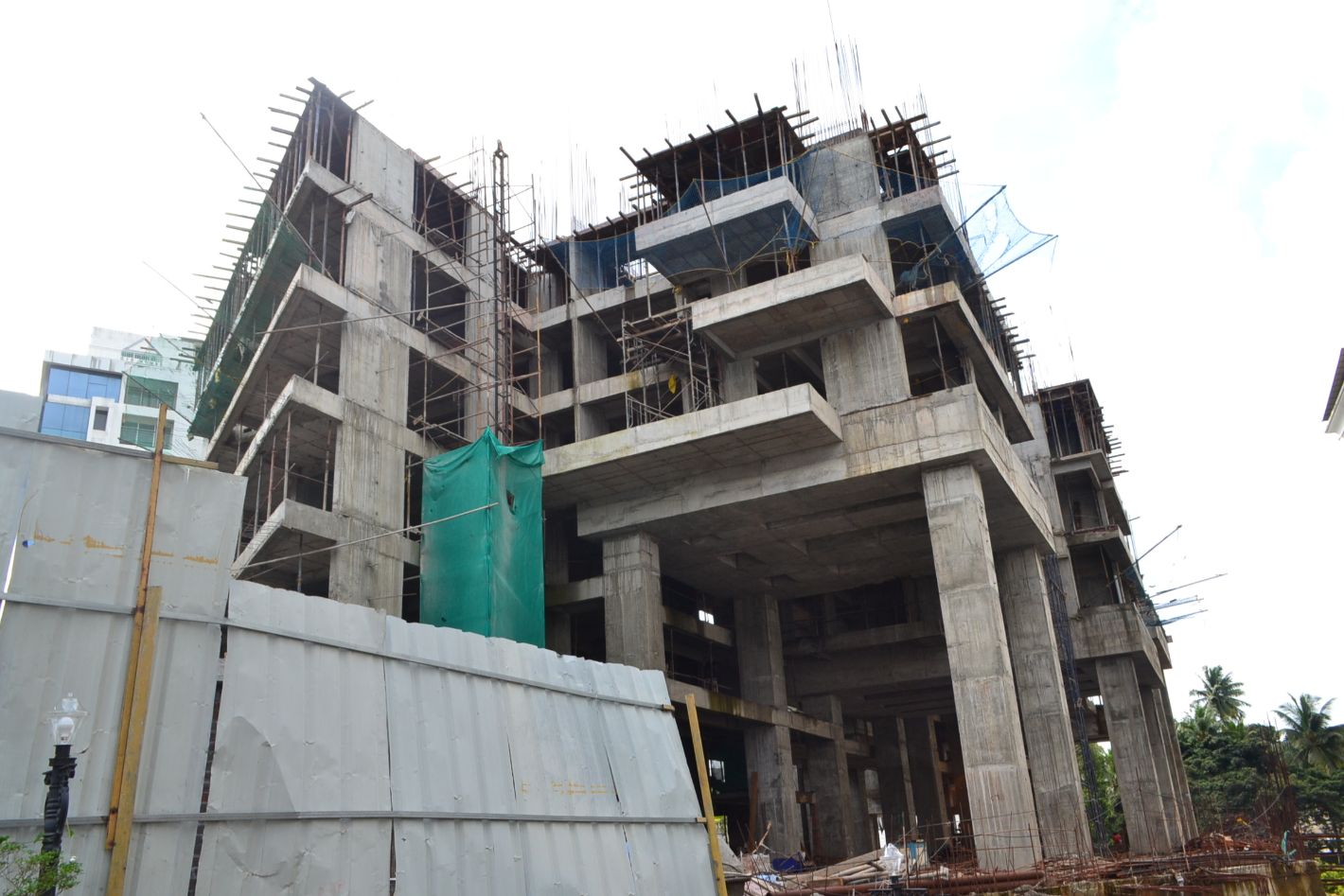

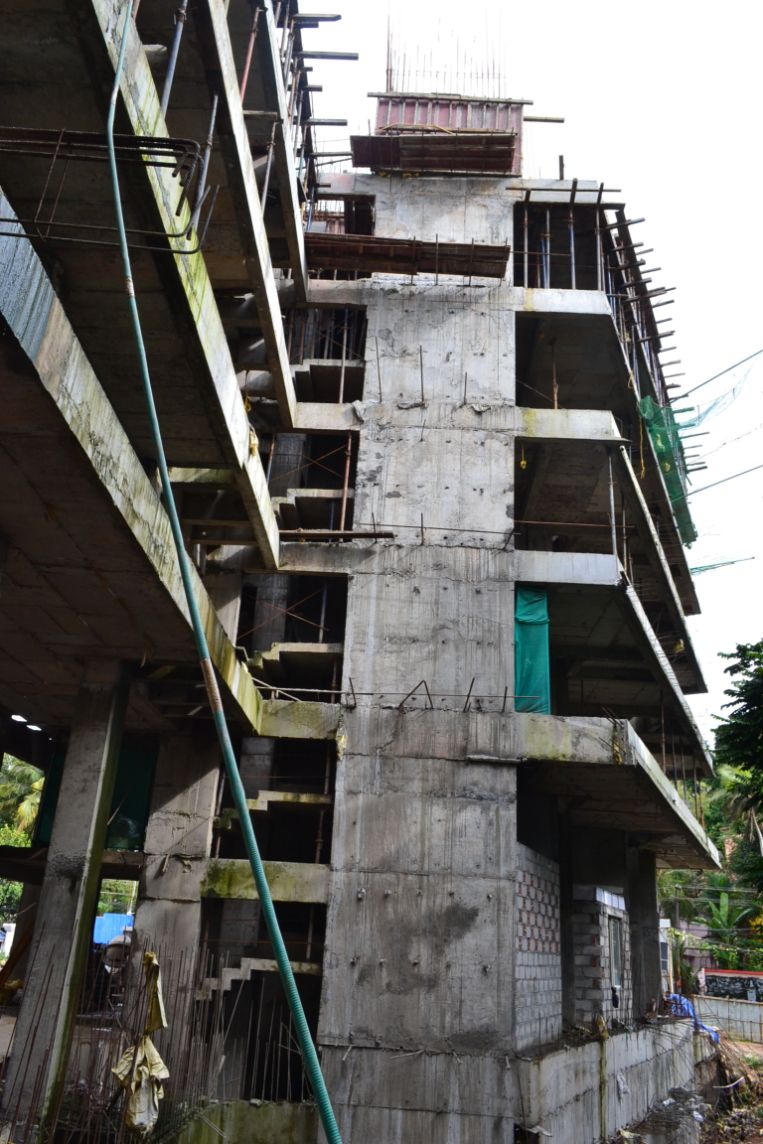

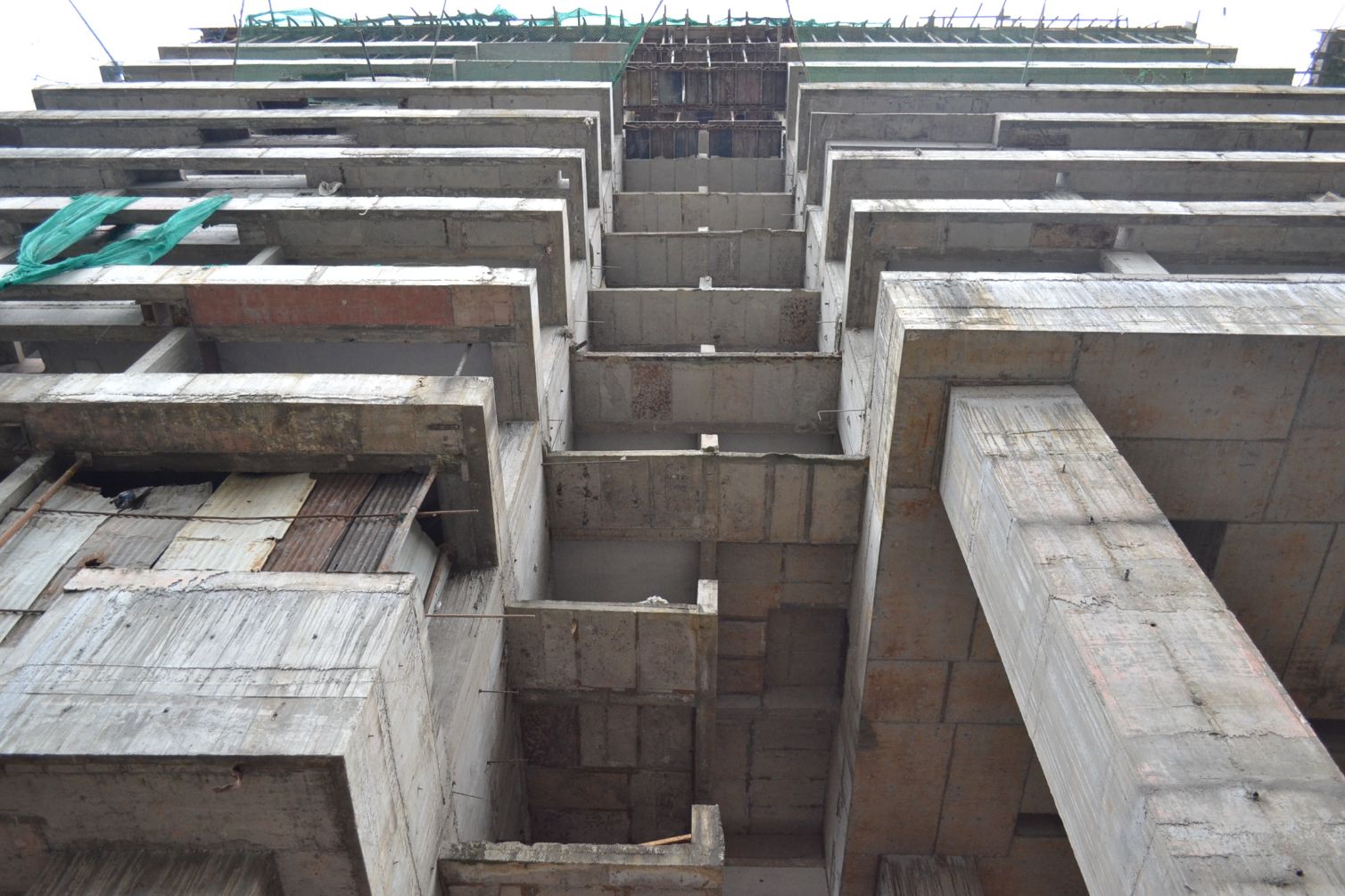

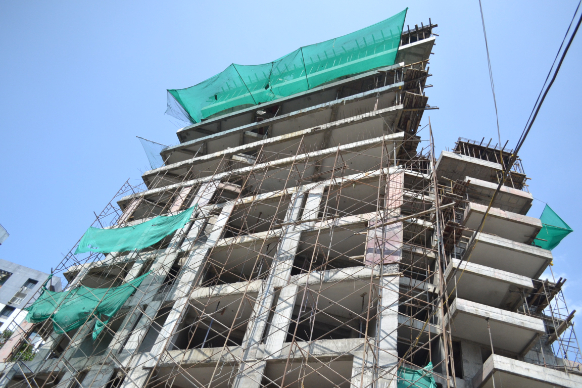

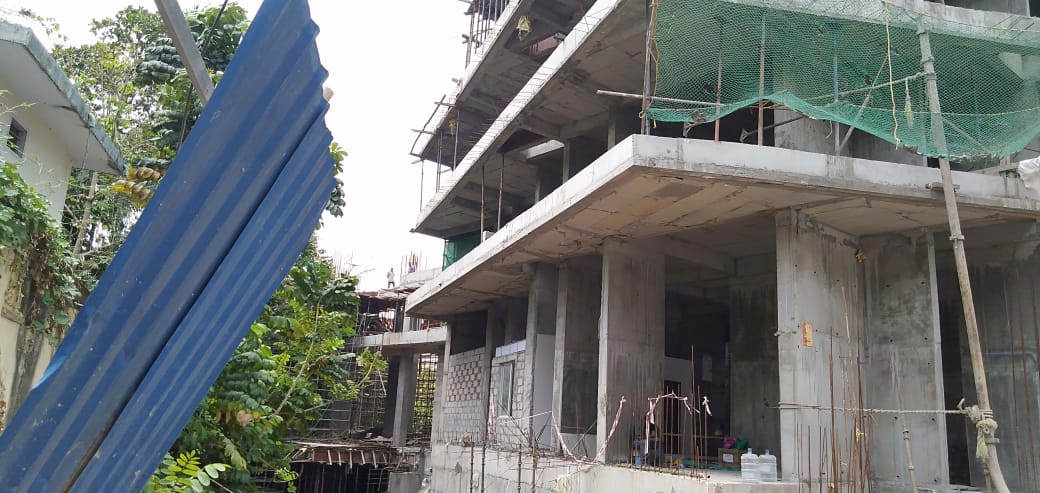

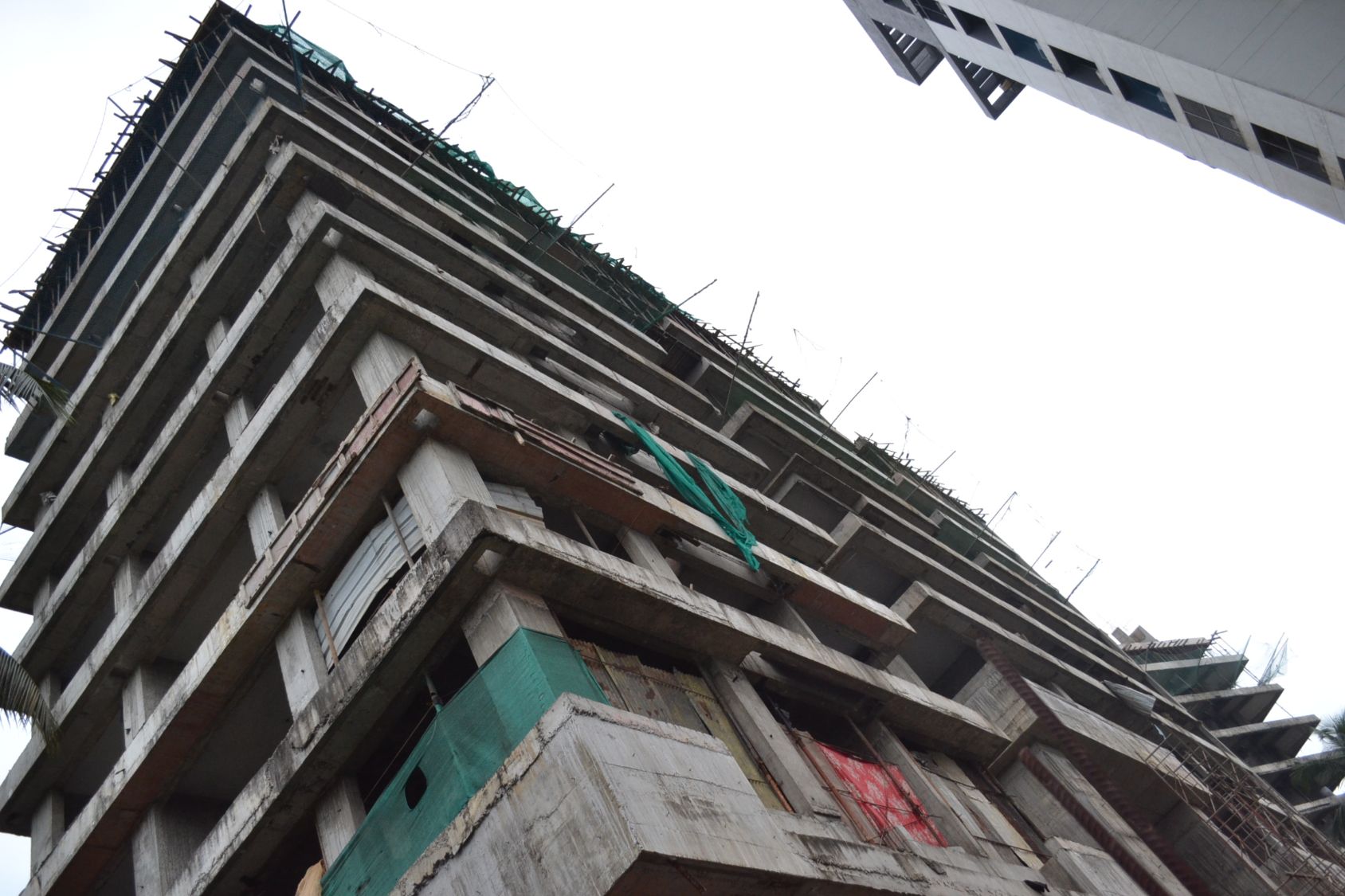

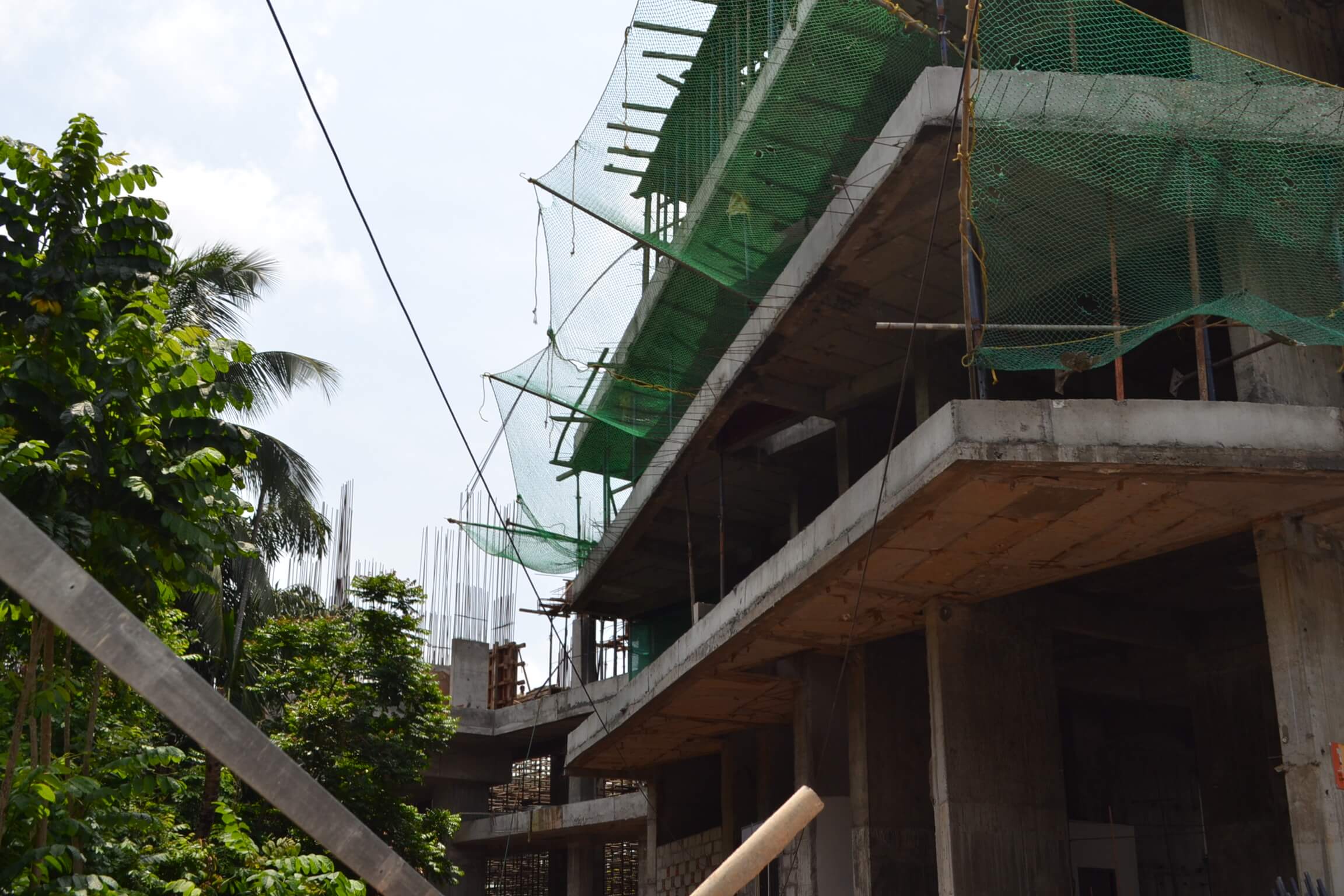

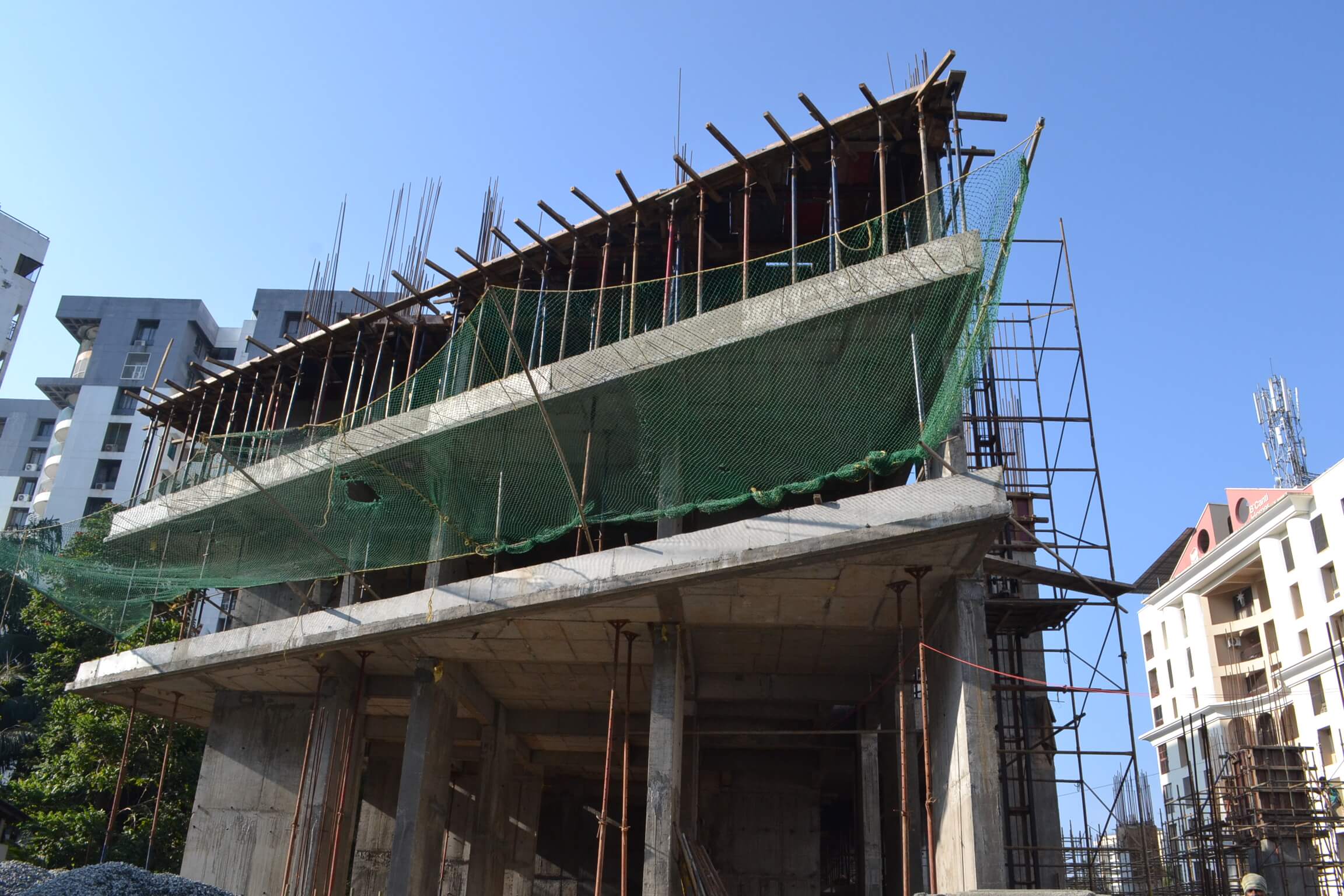

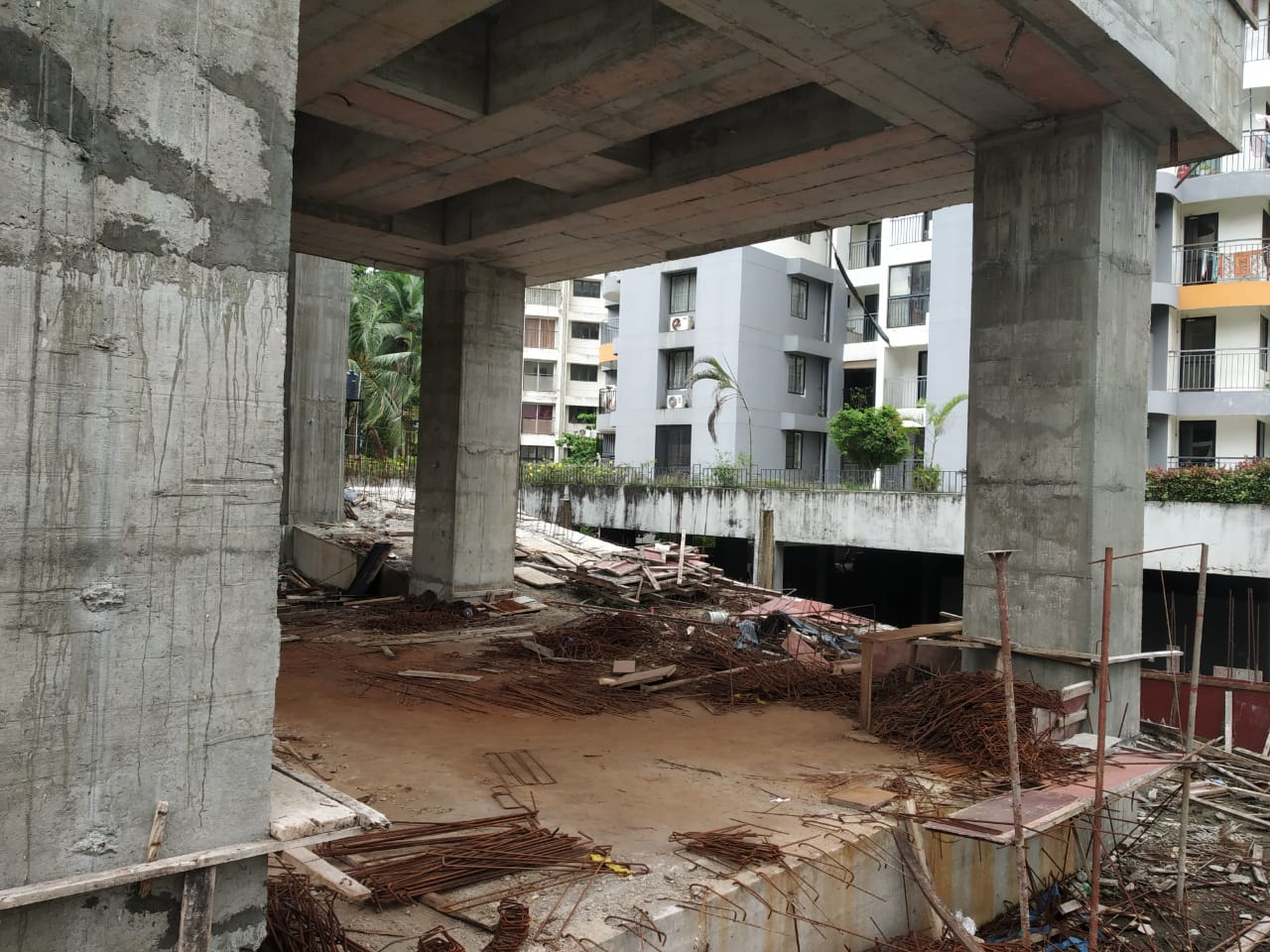

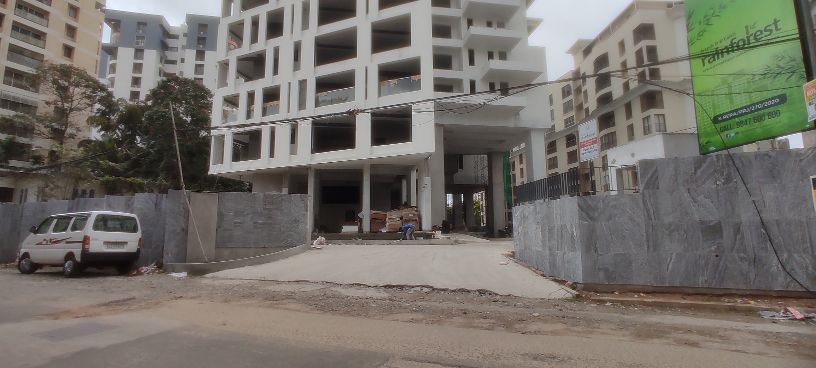

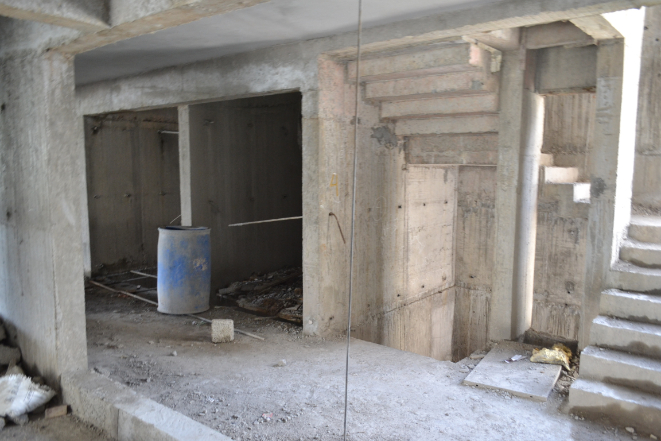

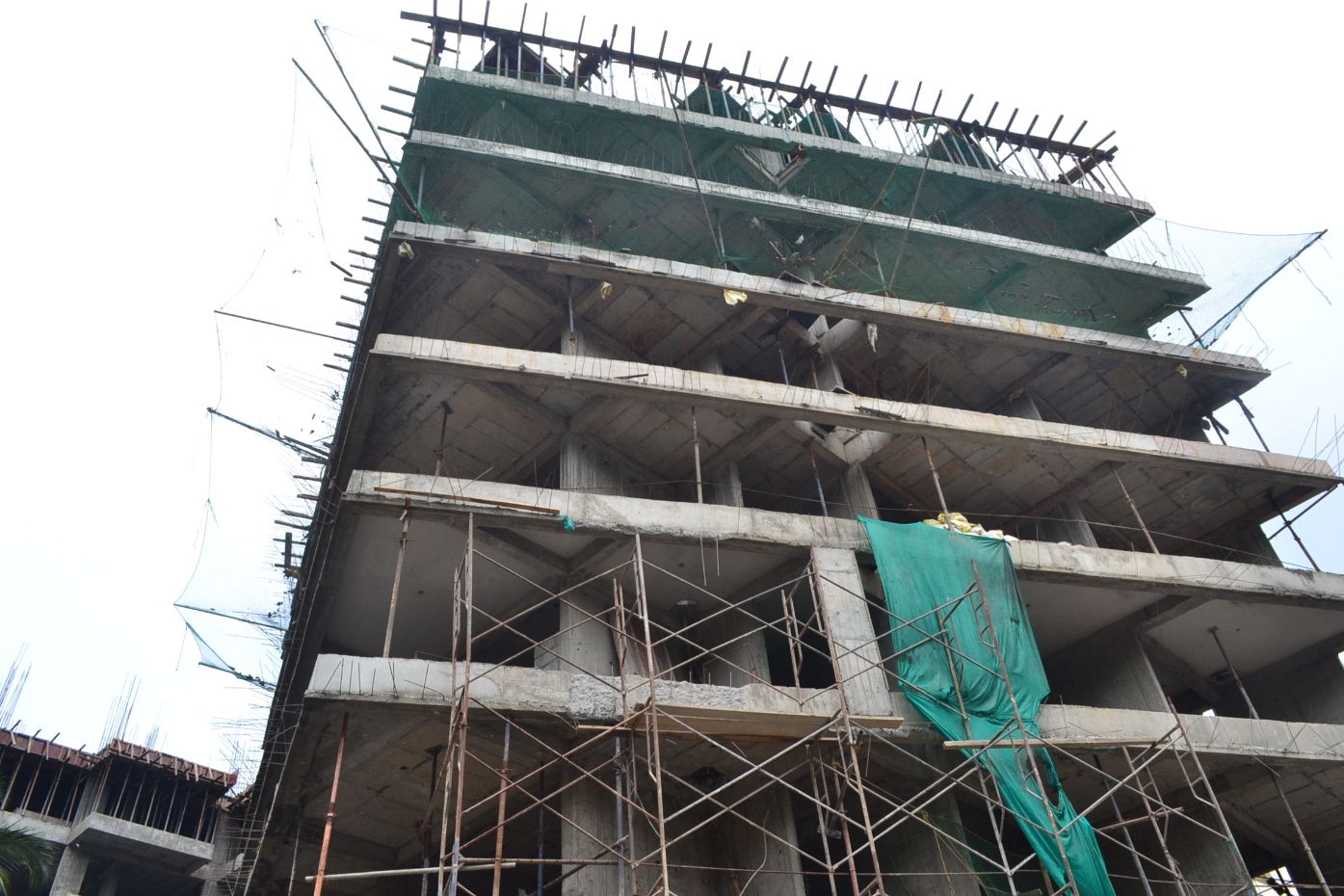

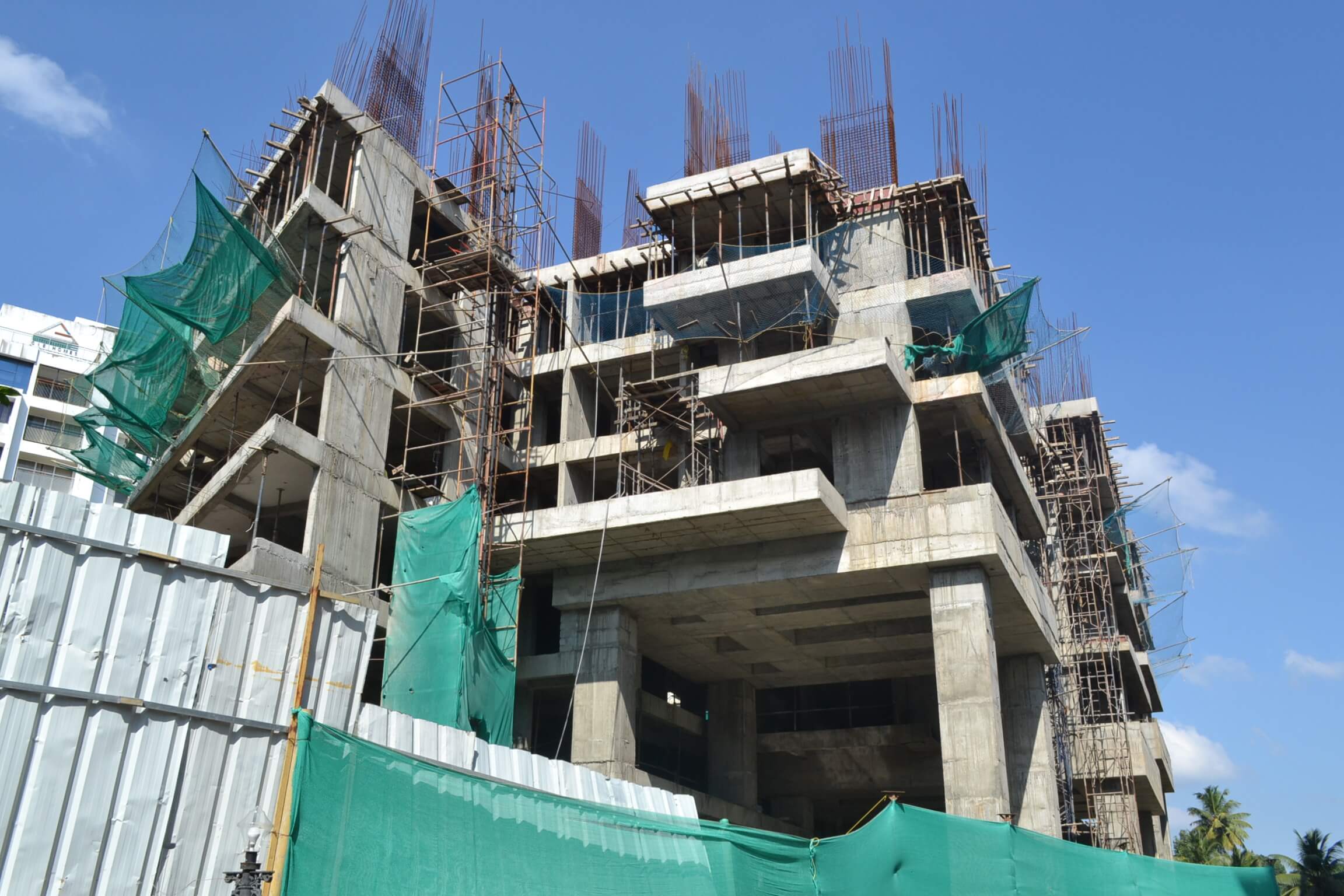

            • External (1st coat) Putty work  -at south and west -85% completed.
            • External (2nd coat) Putty work  -at south and west -85% completed.

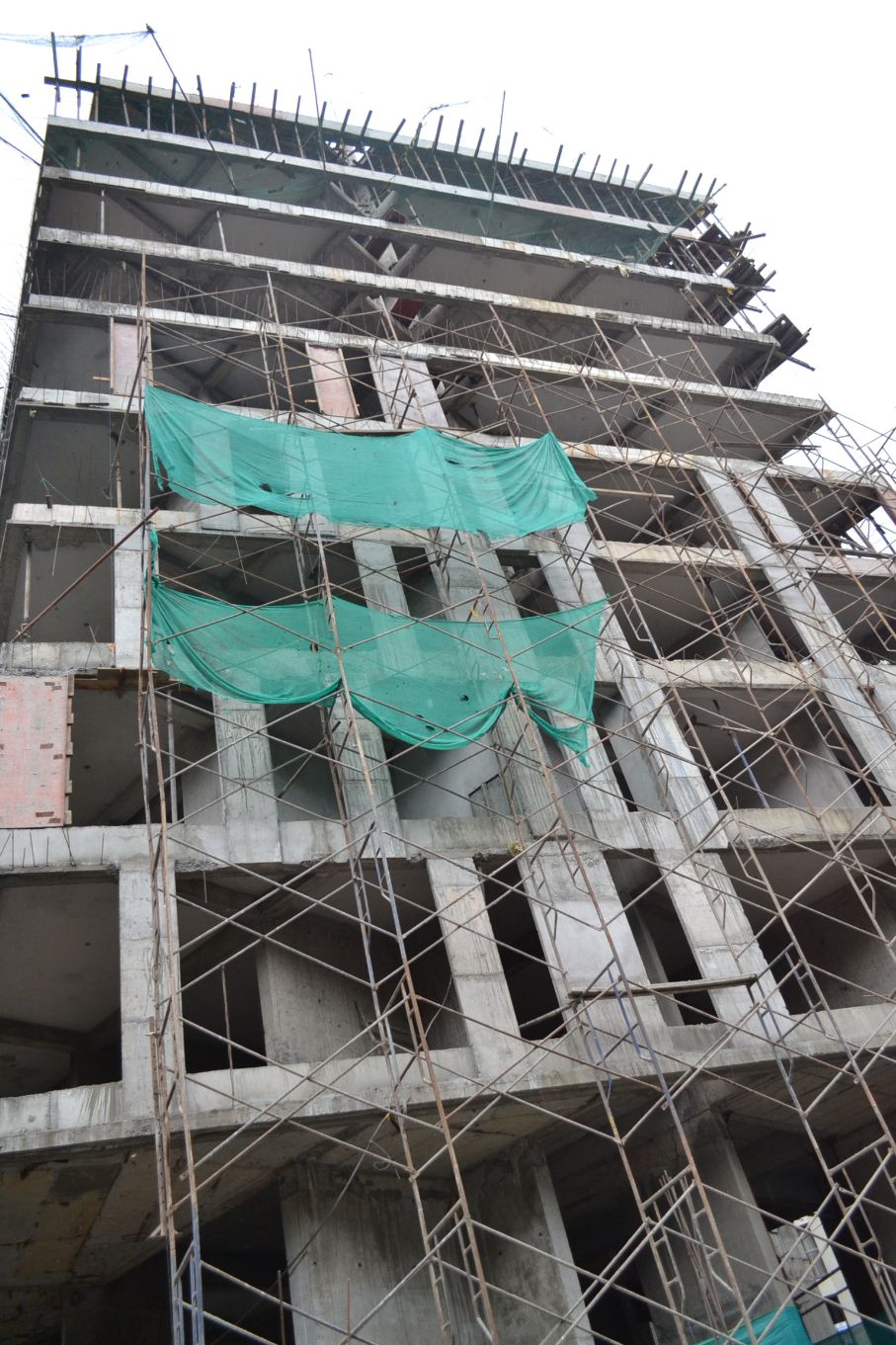

            • Primer – at south and west -85% completed.’

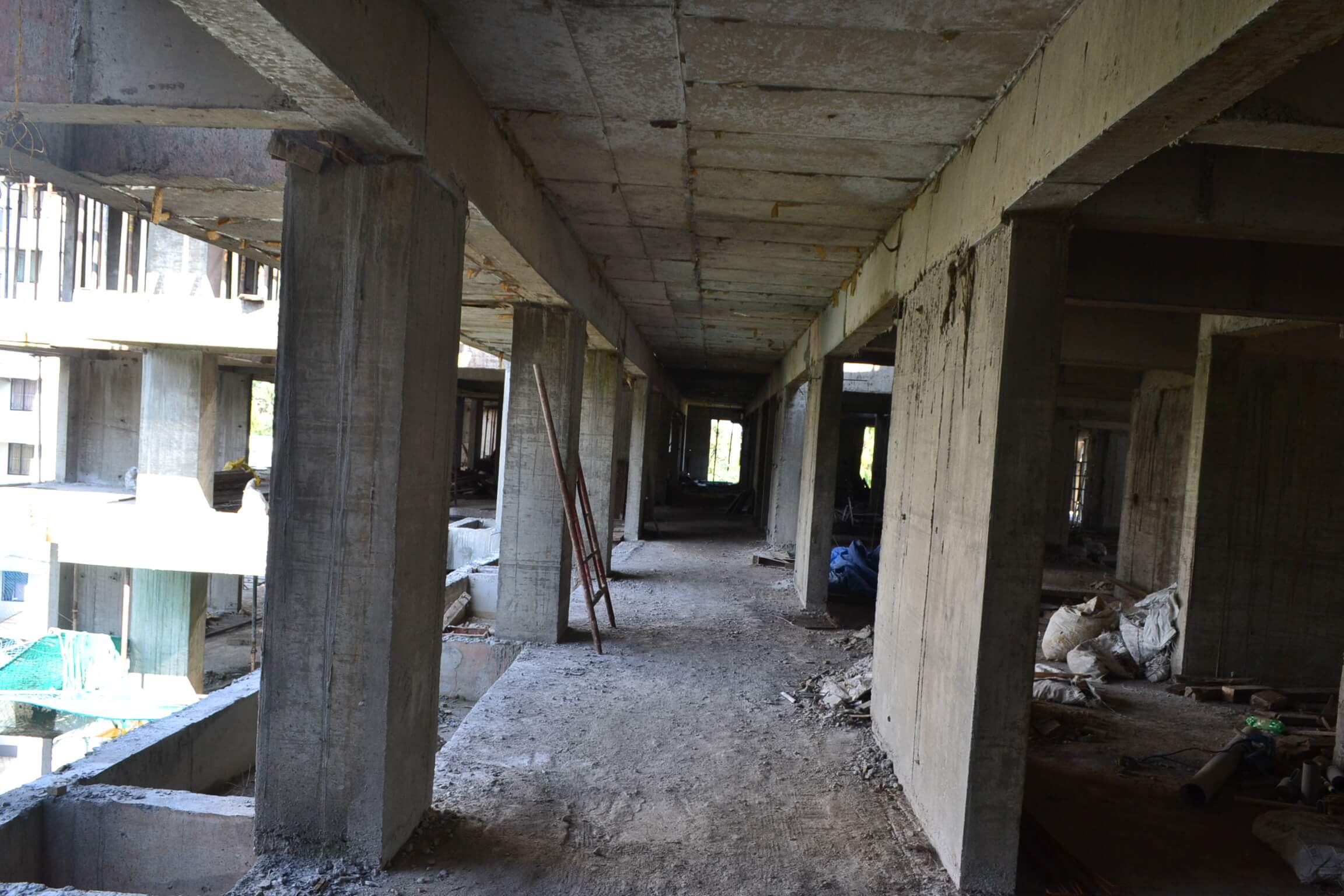

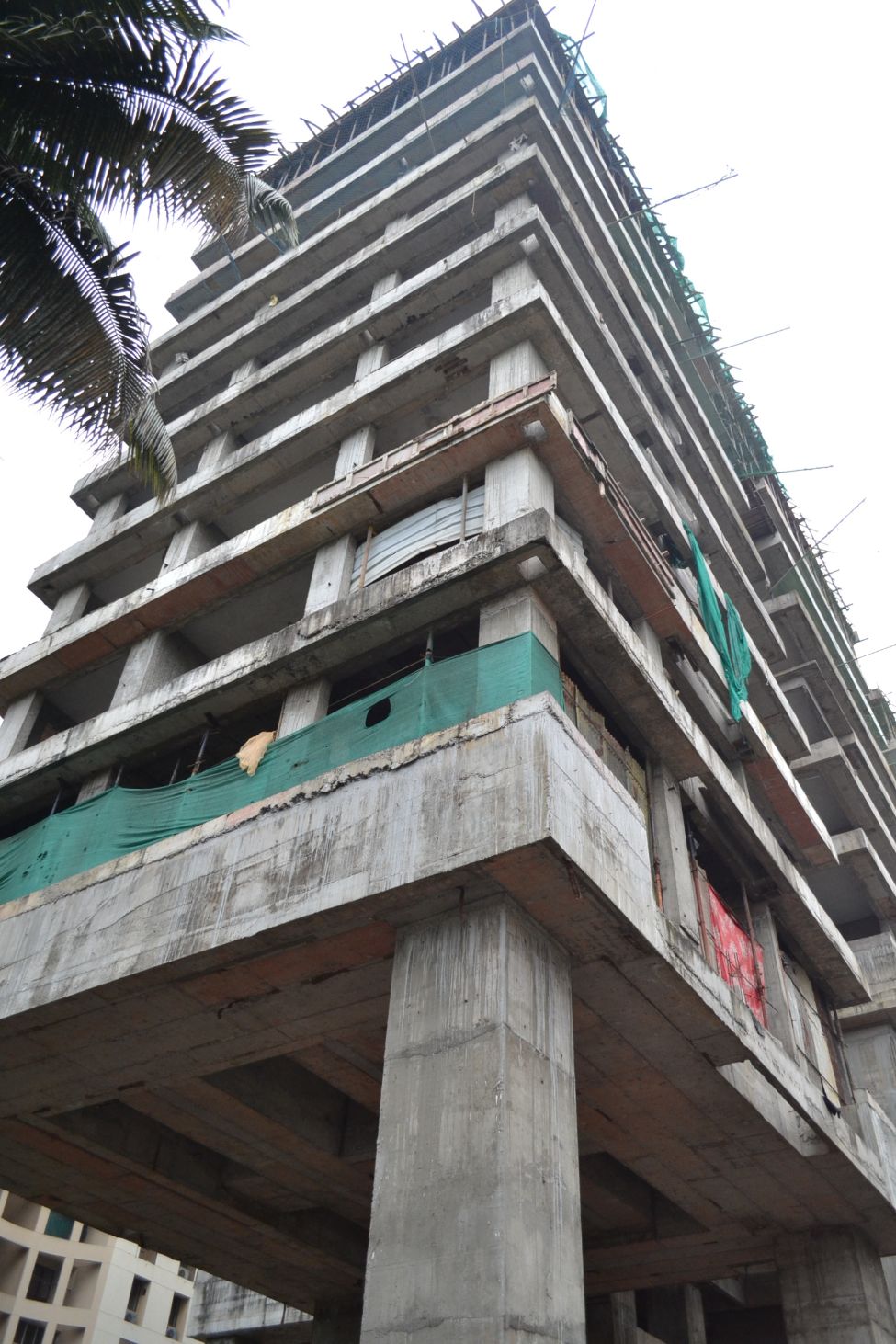

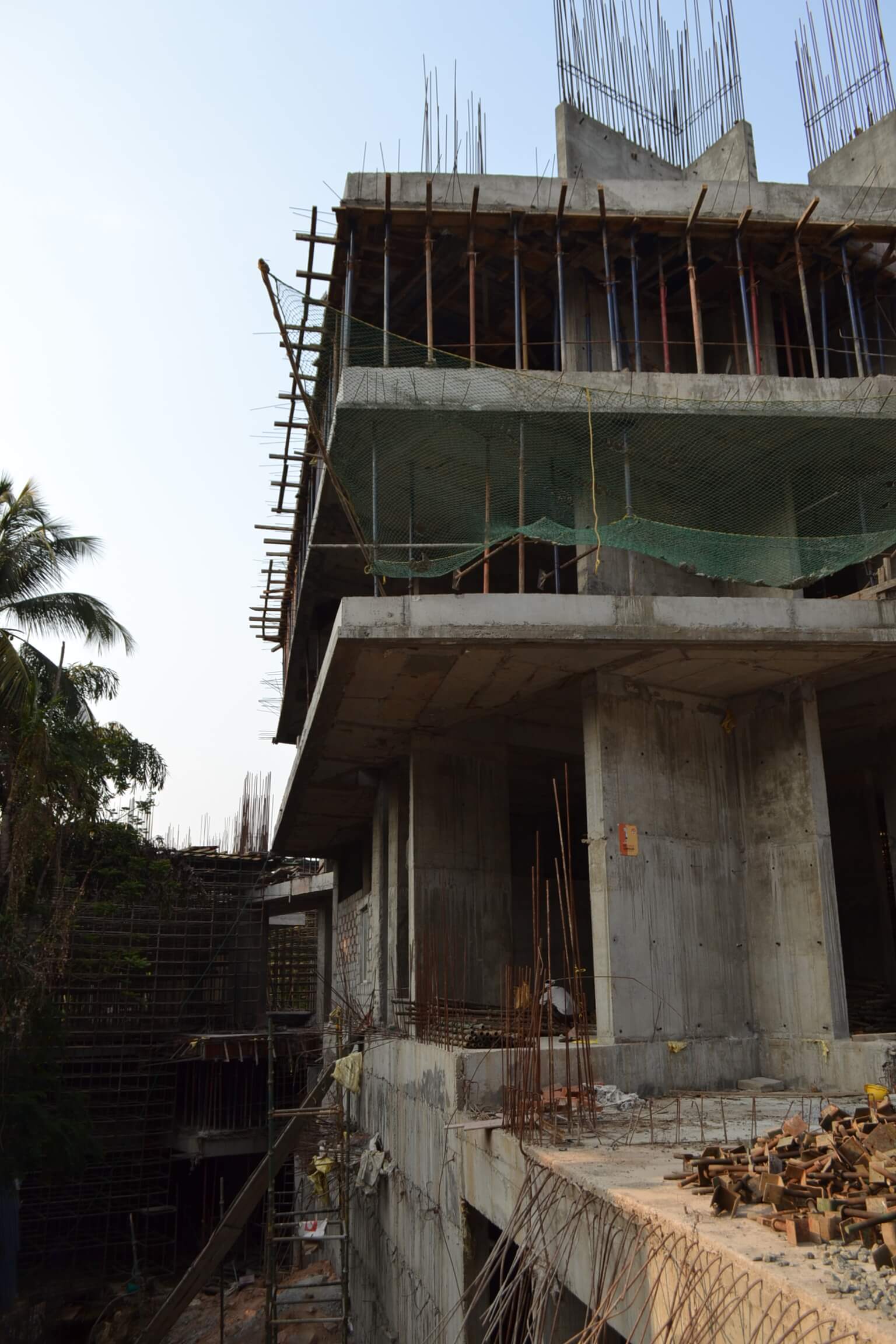

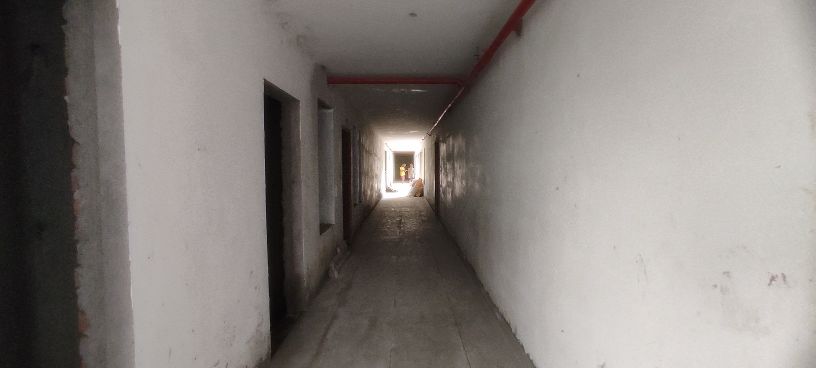

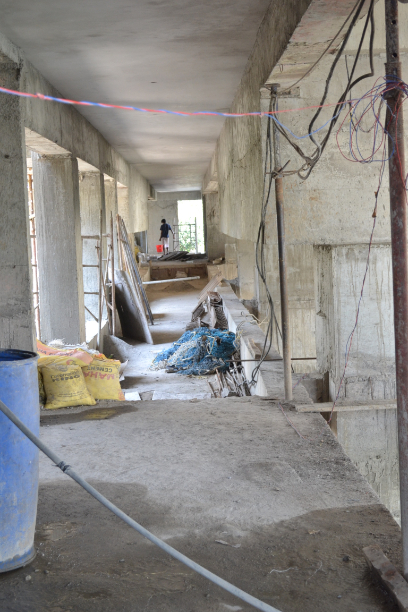

            • Plumbing  work – upto 17th floor- 100% completed

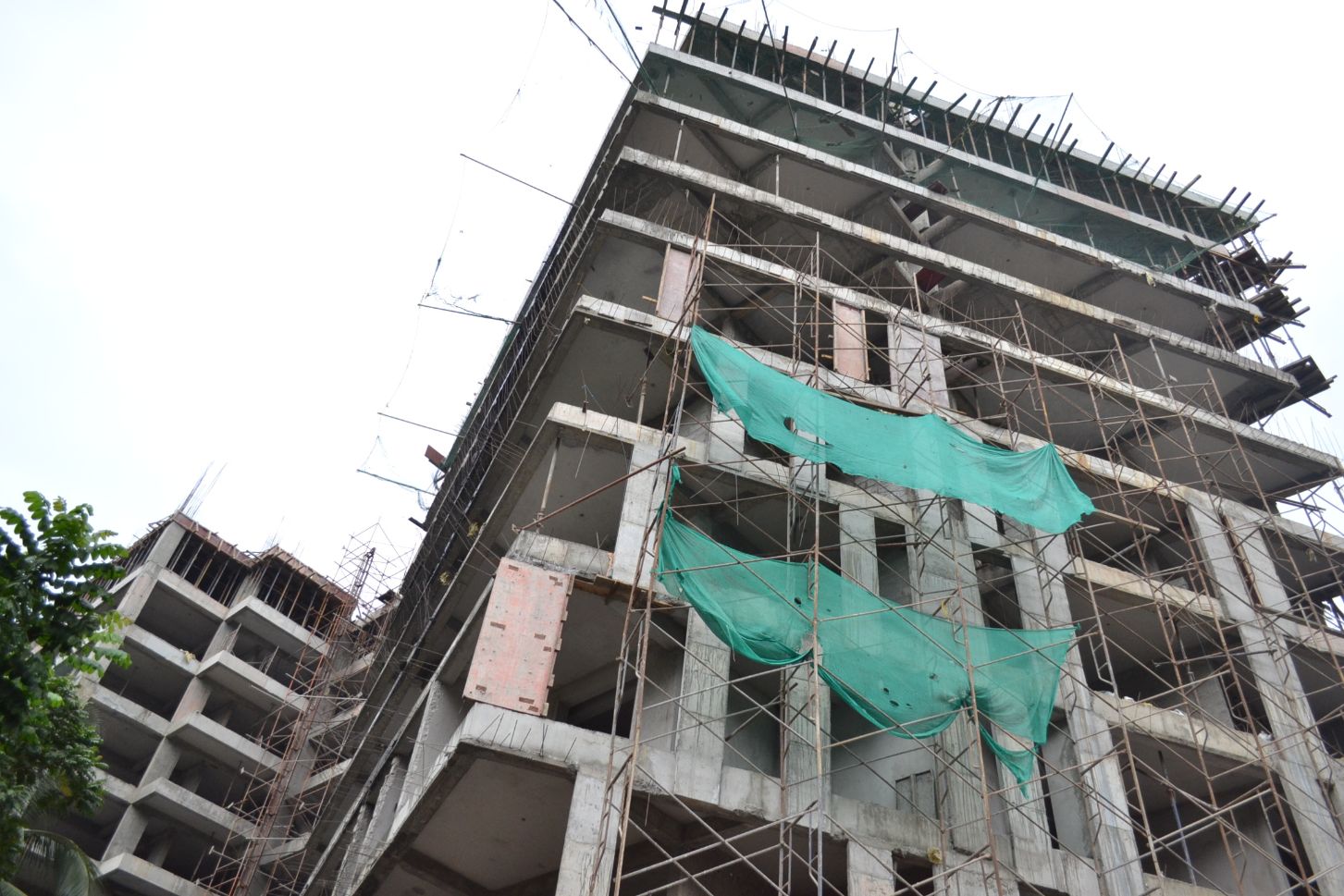

            • Flooring and skirting ,, -GF,15th floor-25% Completed 3rd-5th ,7th,8th,11th,12thfloor:-100% completd,1st,6th,9th,10th floor -80% completed,,13th-14th floor:-50% completed.
            • Fixing of door shutters -1st Floor -25%completed
            • Fire Fighting work :GF-18th floor-85% completed

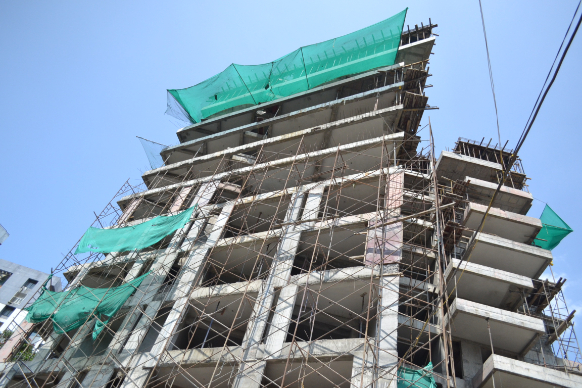

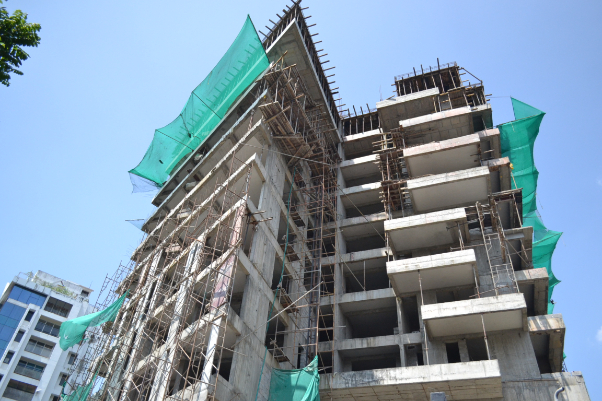

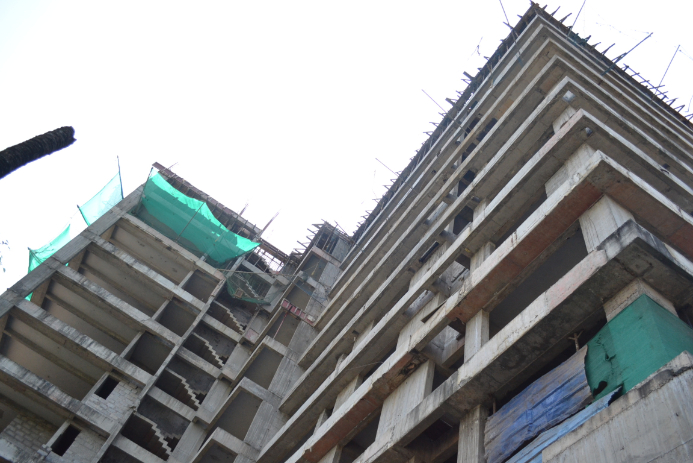

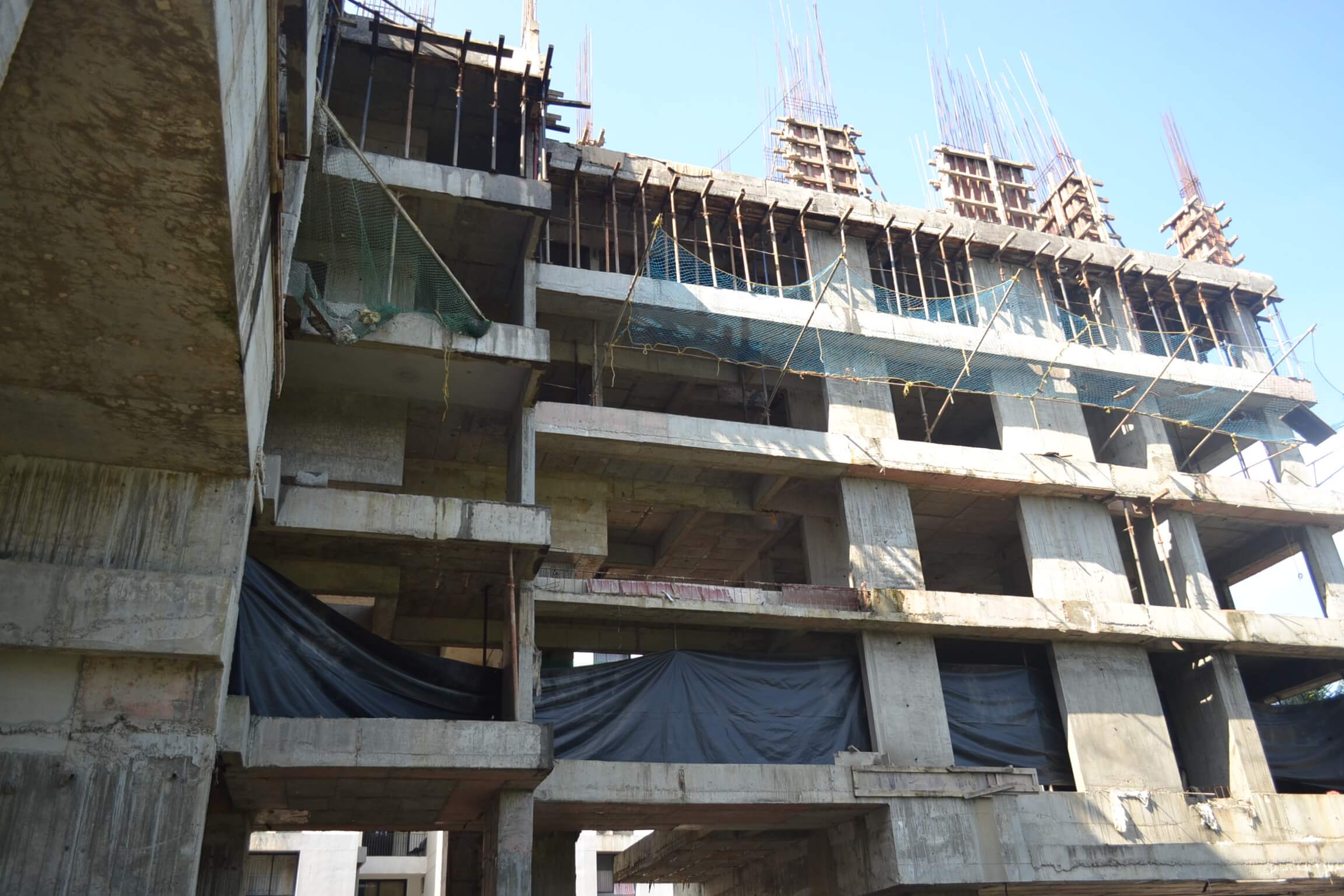

Tower 2

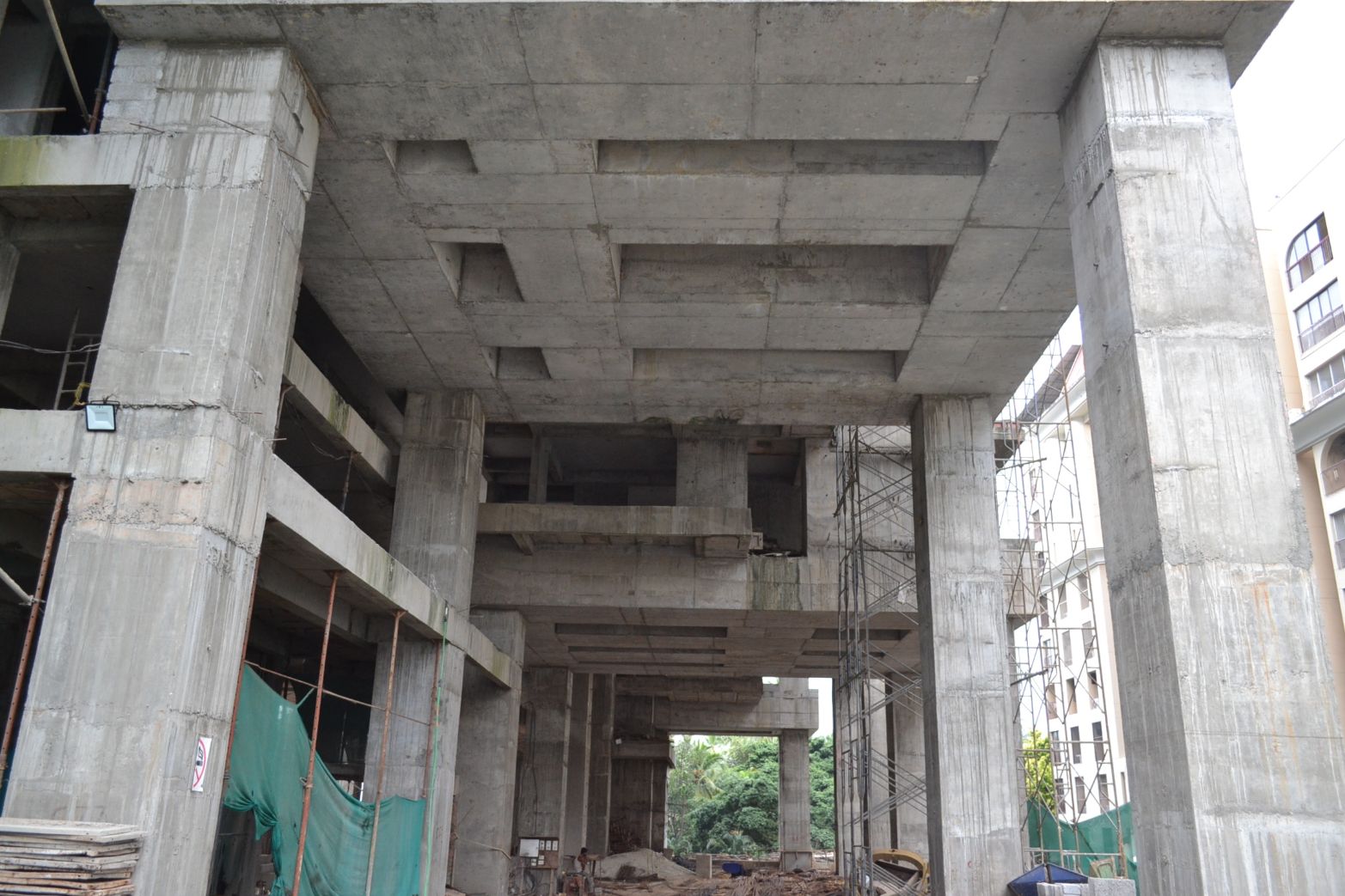

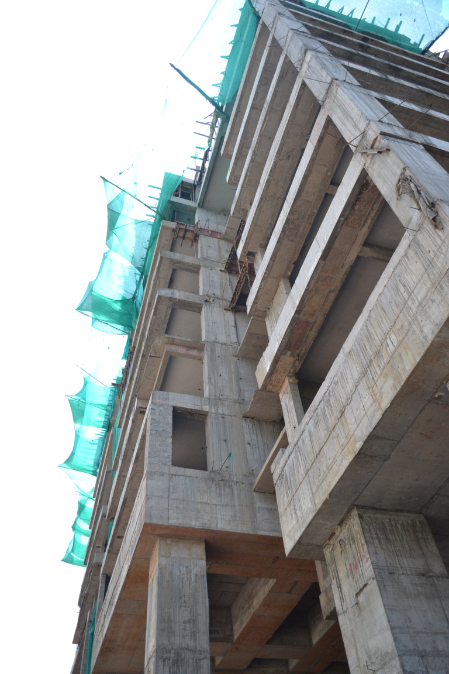

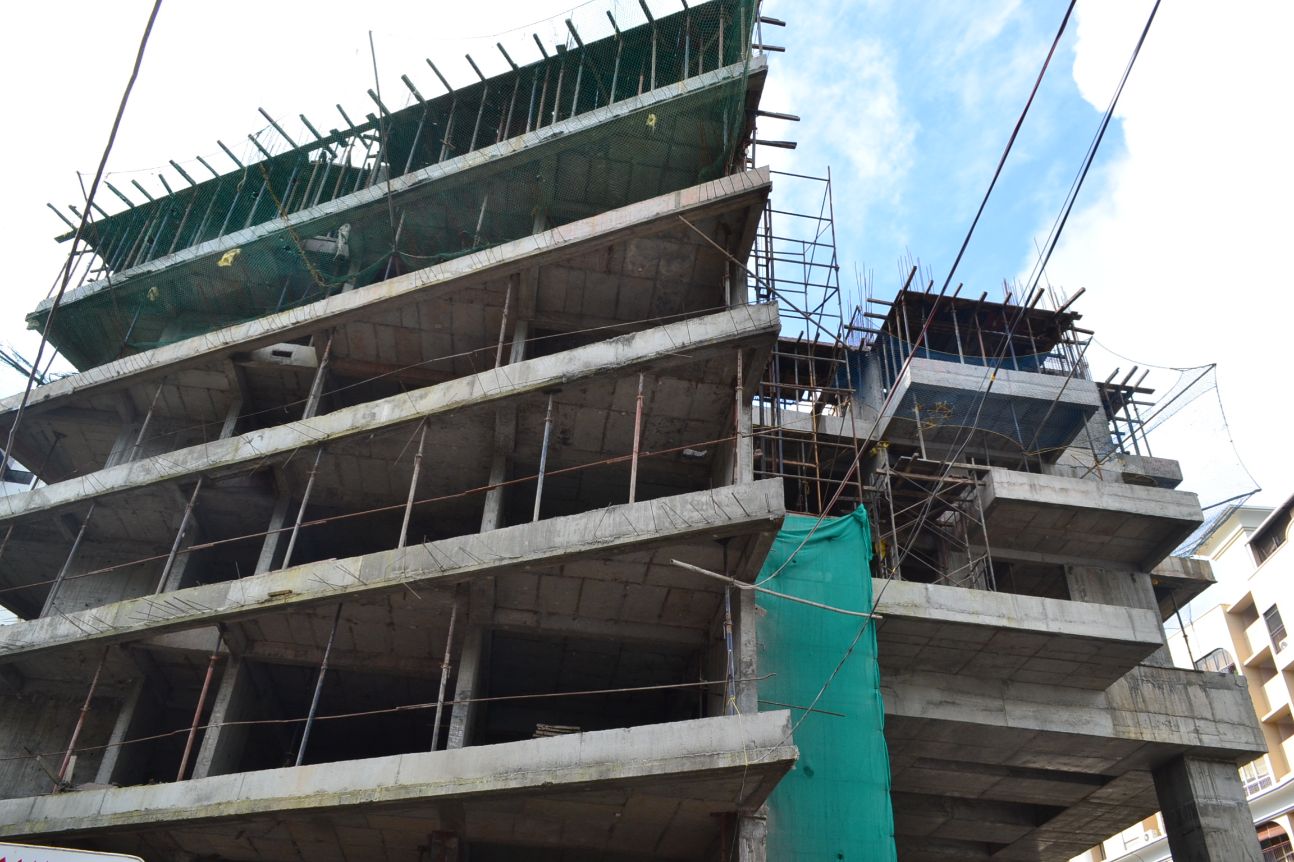

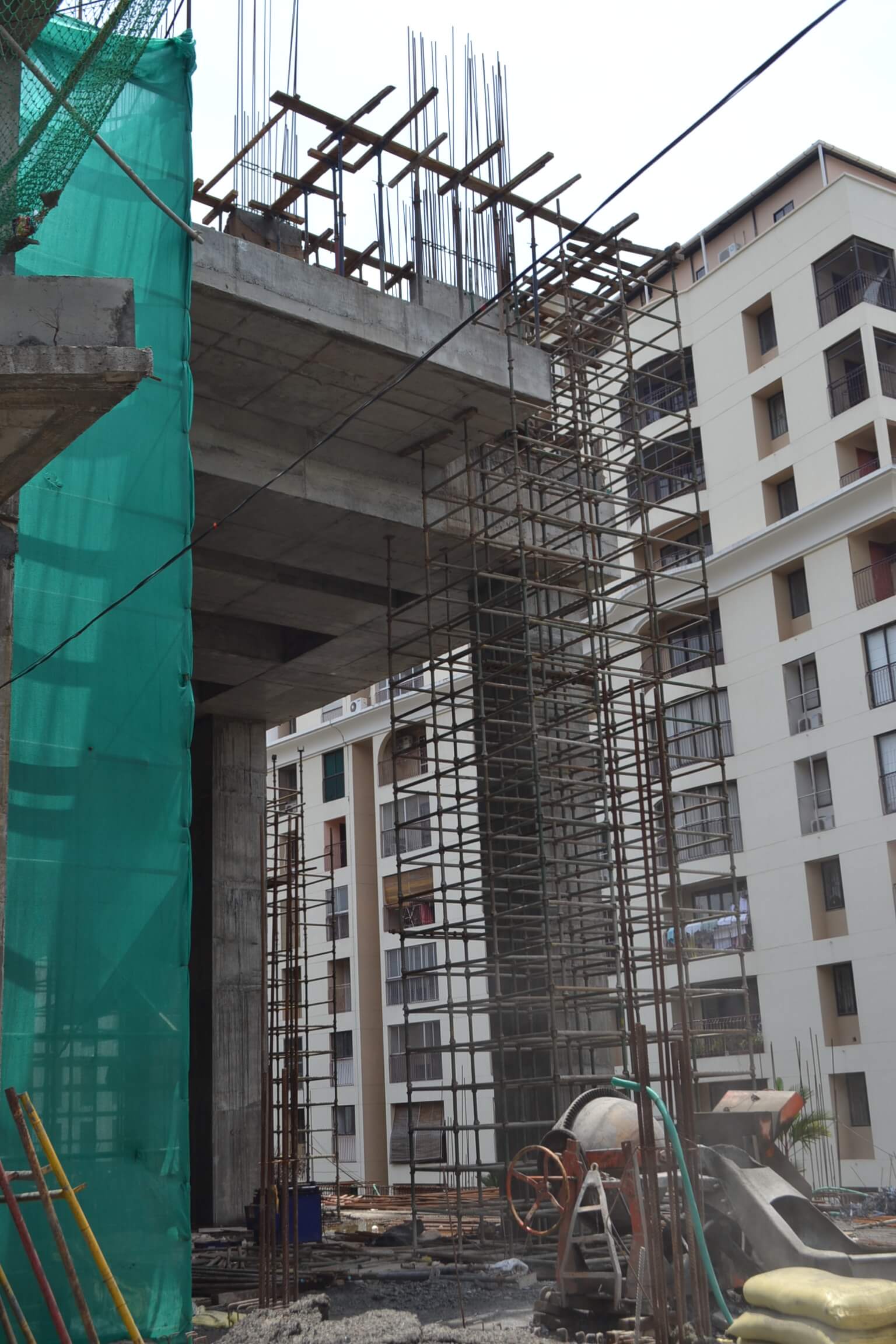

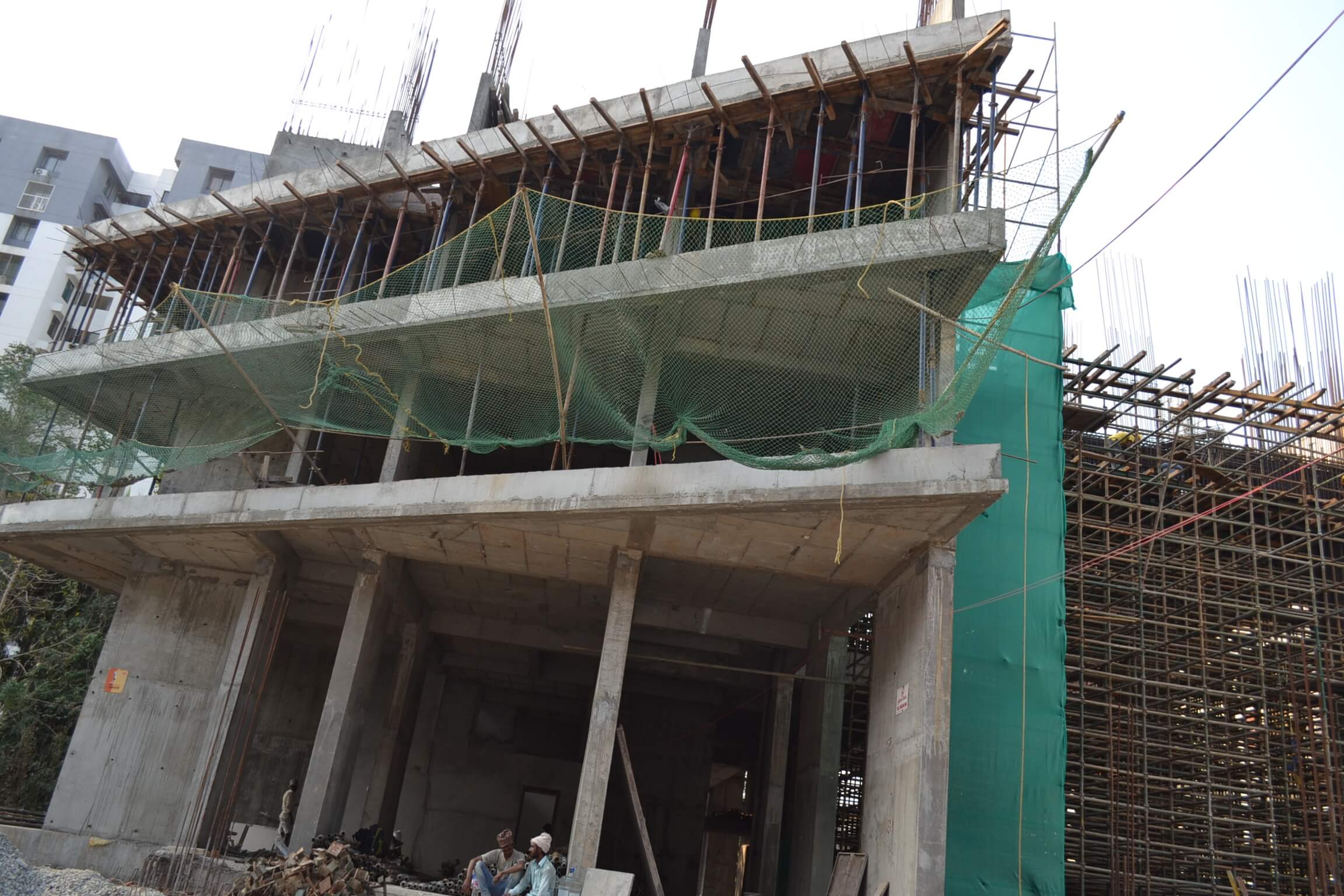

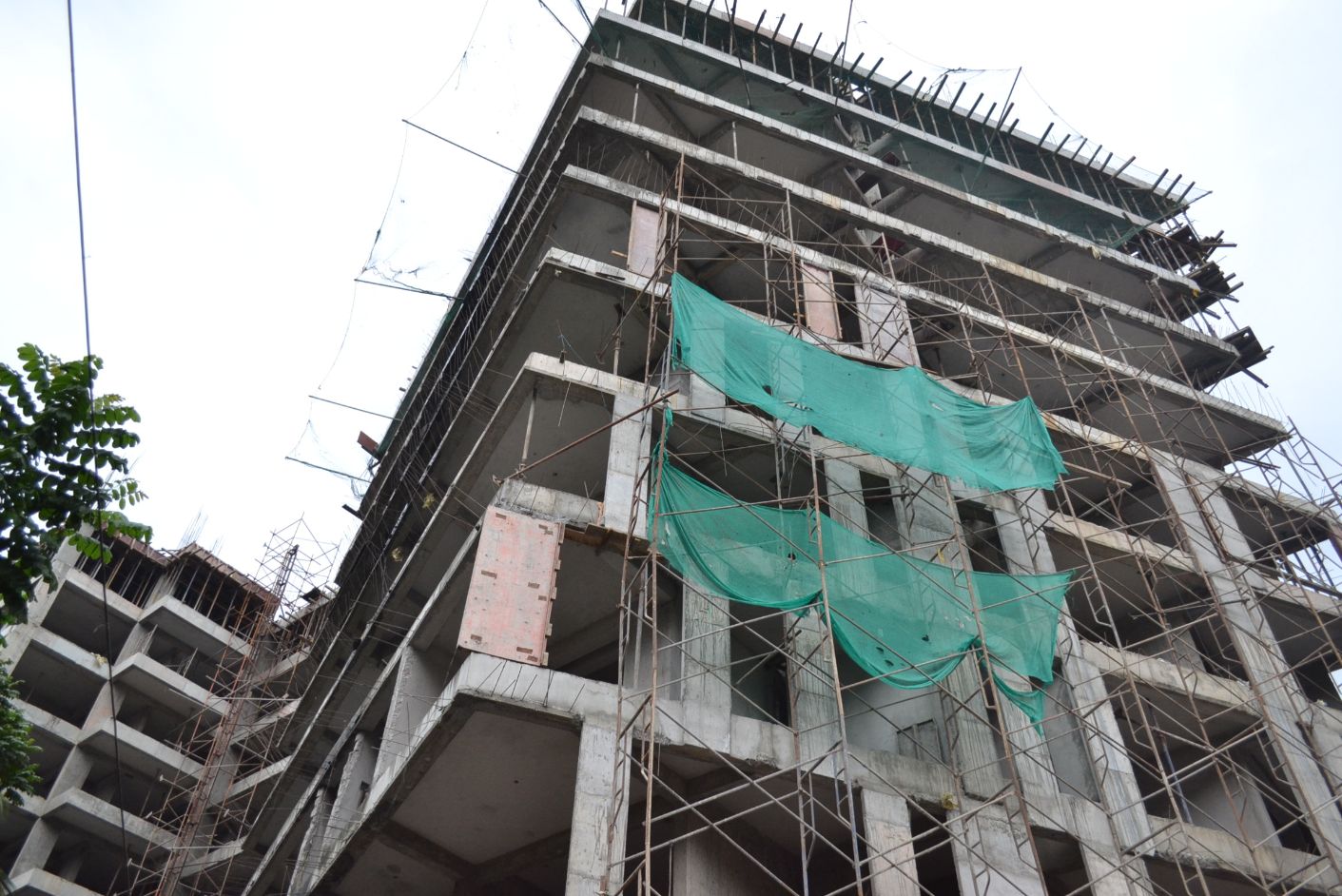

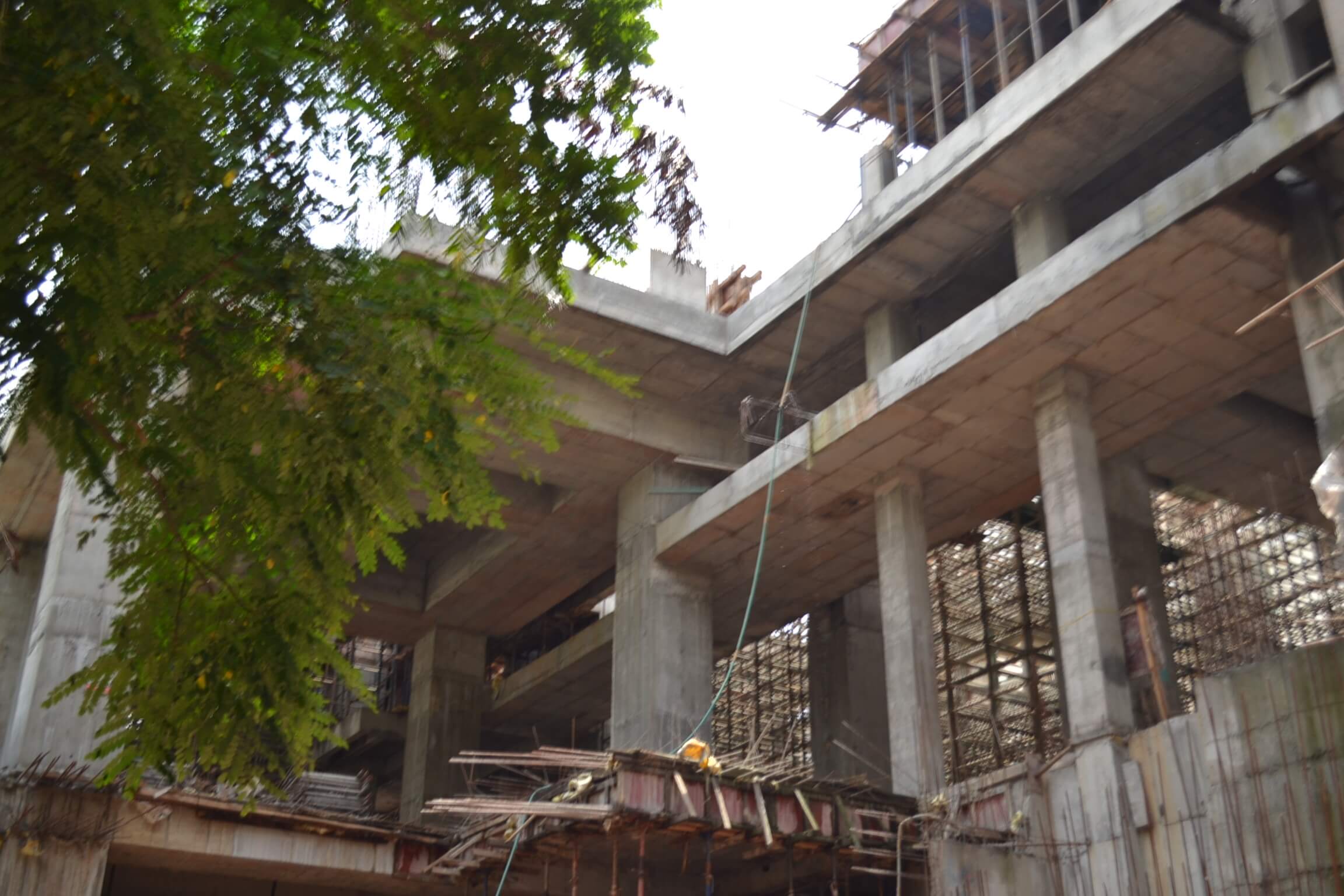

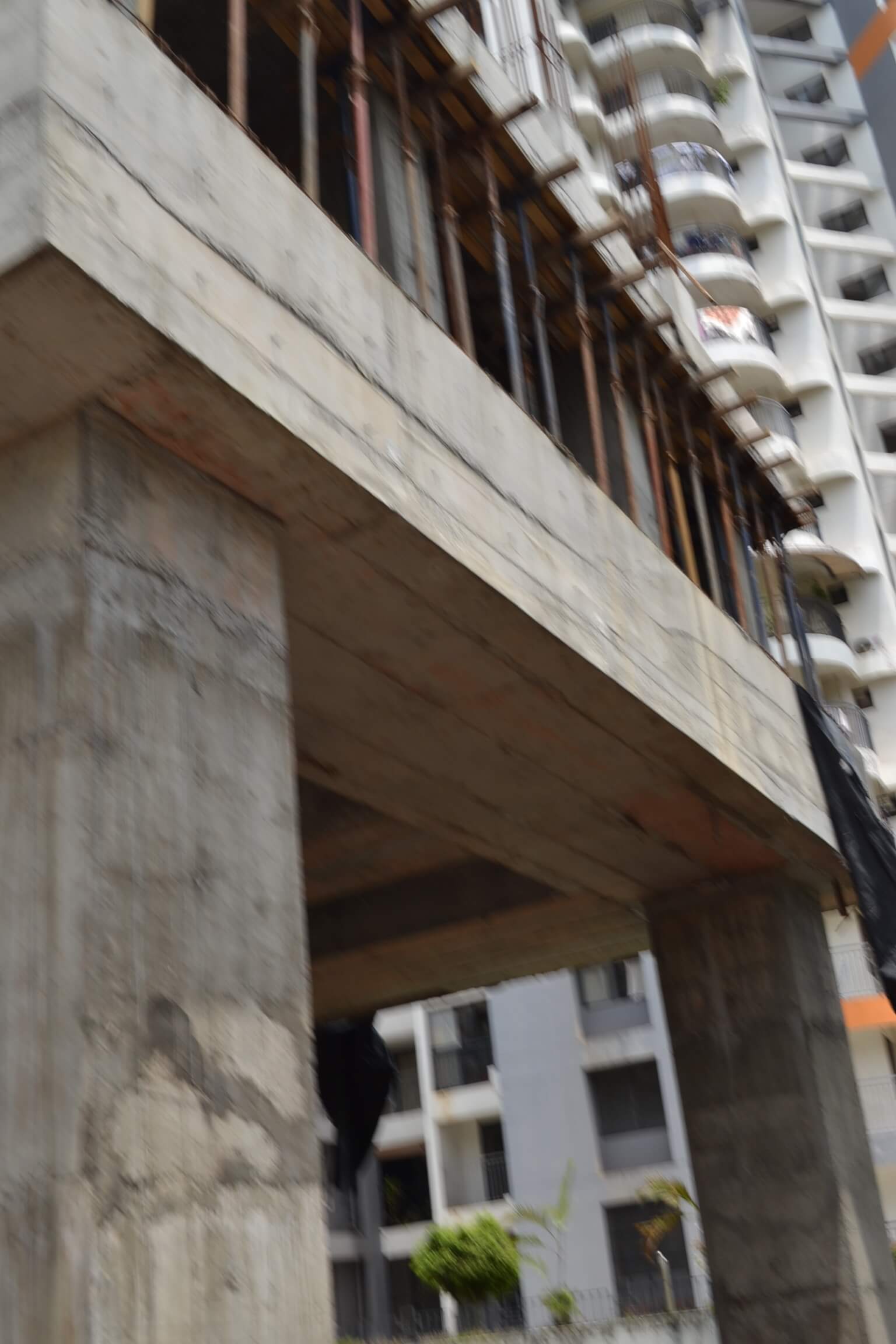

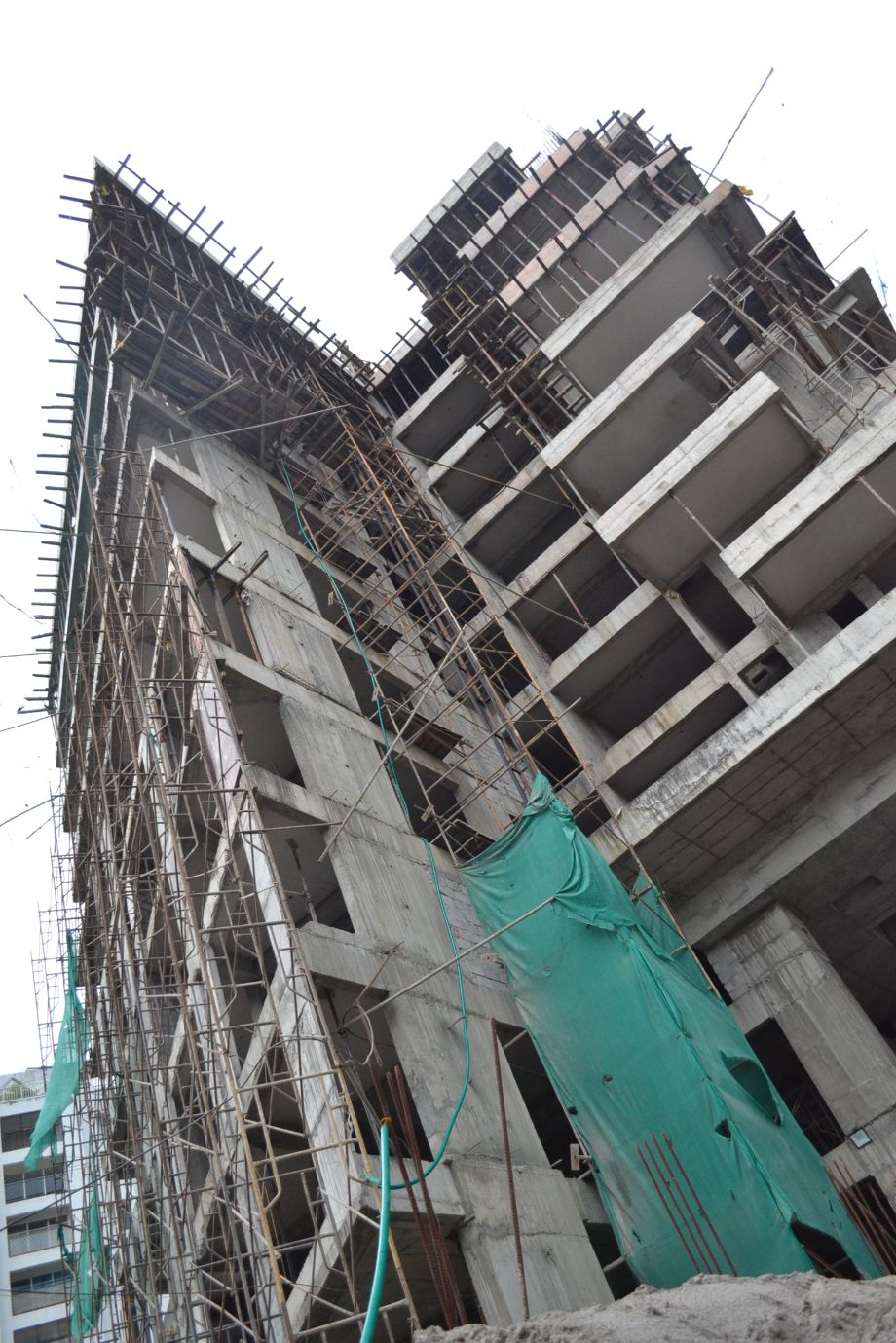

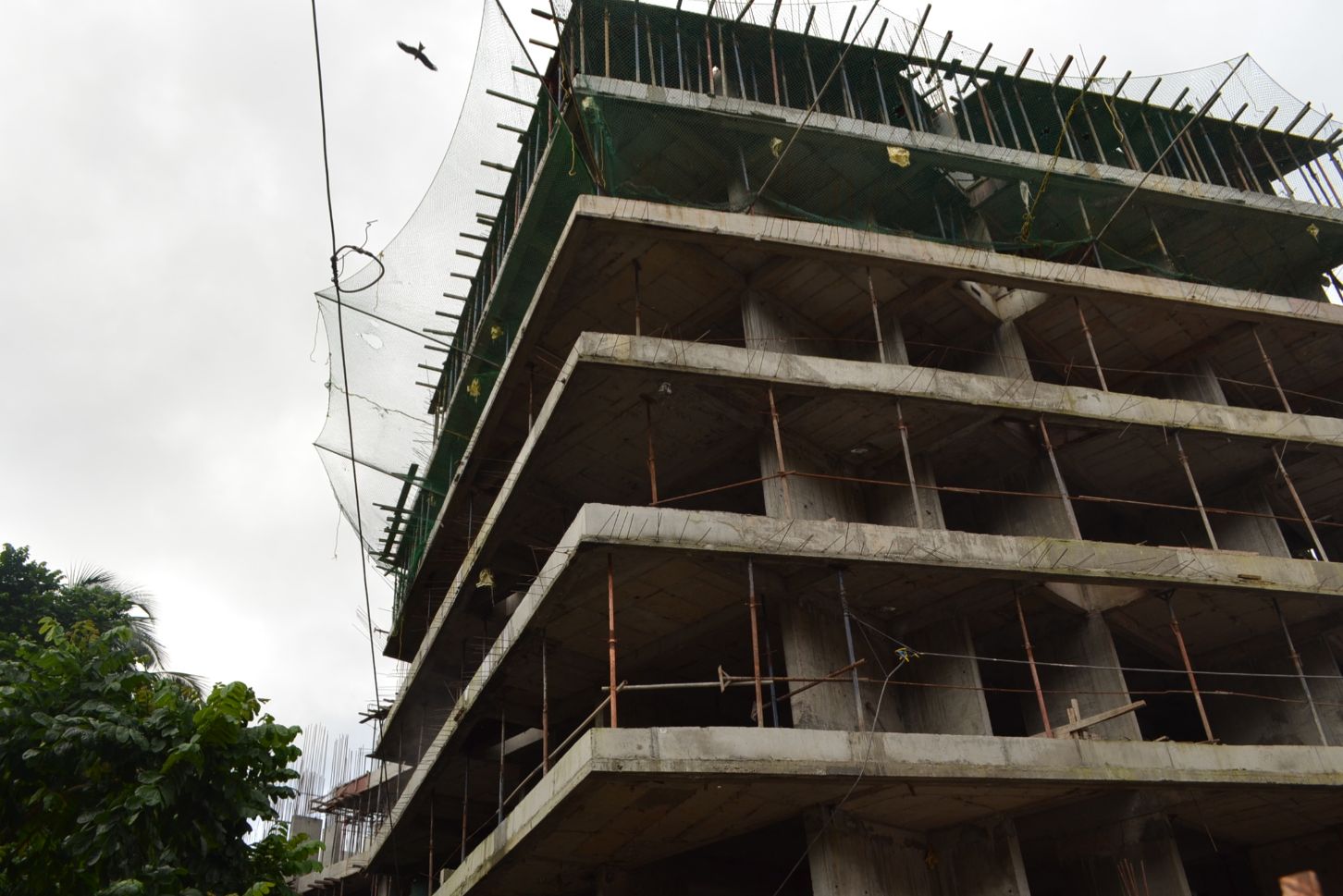

            • RCC for slab – Upto 10th floor- 100% completed, 11th floor-60% completed.
            • Ceiling plastering : BF3-90% completed
            • Electrical Wall Chasing: 1st floor-4th floor- 100 %  completed.
            • Wall Plastering: 1st – 2nd floor-100% completed.

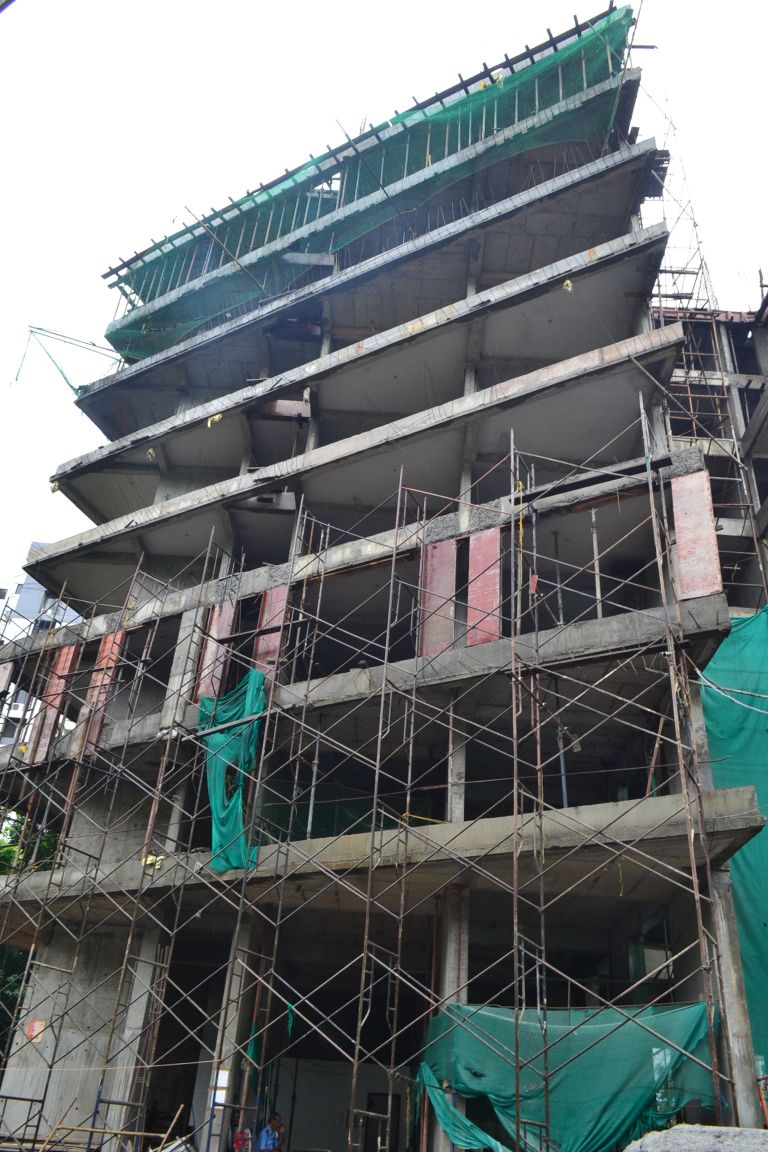

            • Block Work

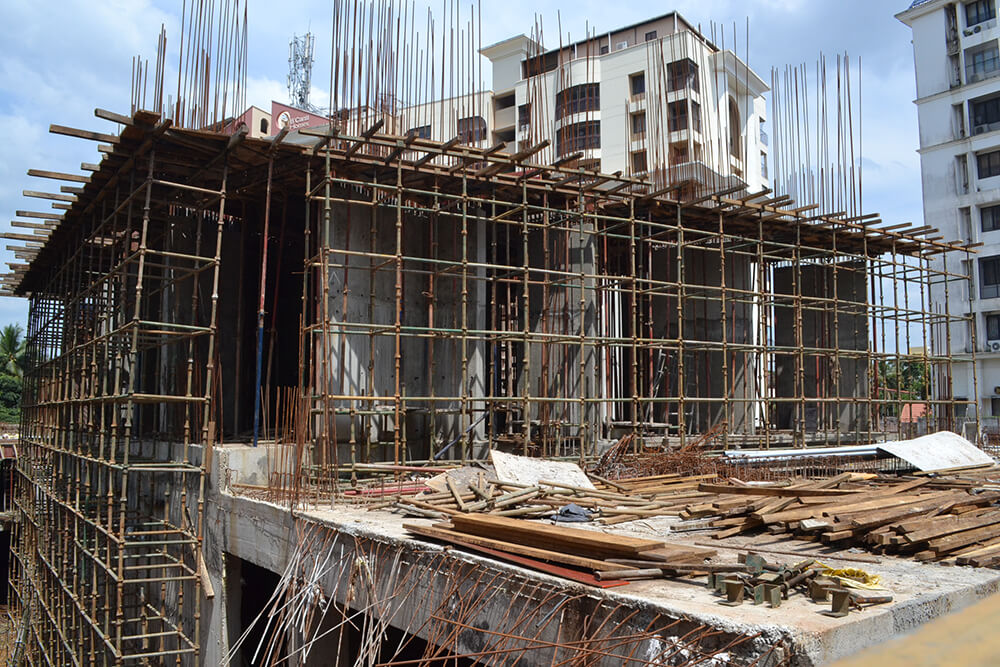

              • GF -75%  completed, BF2 :-70% completed, BF1-50% completed , BF3-25% completed.
              • 1st floor-5th floor – 100 %  completed
            • Yard work
              • STP RCC -100%  completed.
              • Front gate -100%  completed.
              • Compound wall-100% completed.

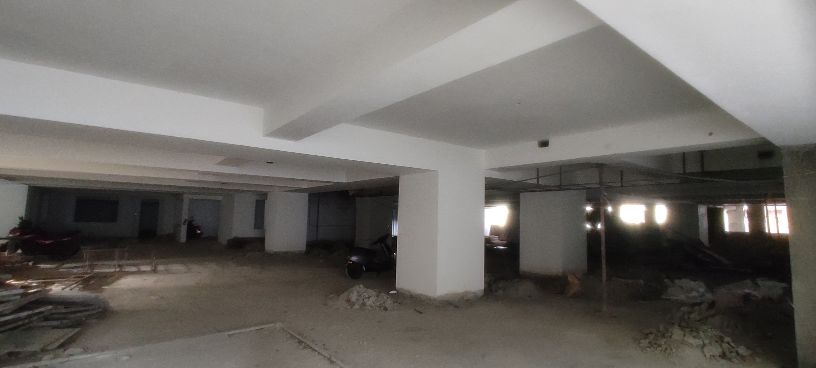

            • MLCP
              • BF1 ceiling & column plastering -100% completed.
              • BF2 ceiling & column plastering -80%  completed.
              • BF3 ceiling & column plastering -50%  completed.

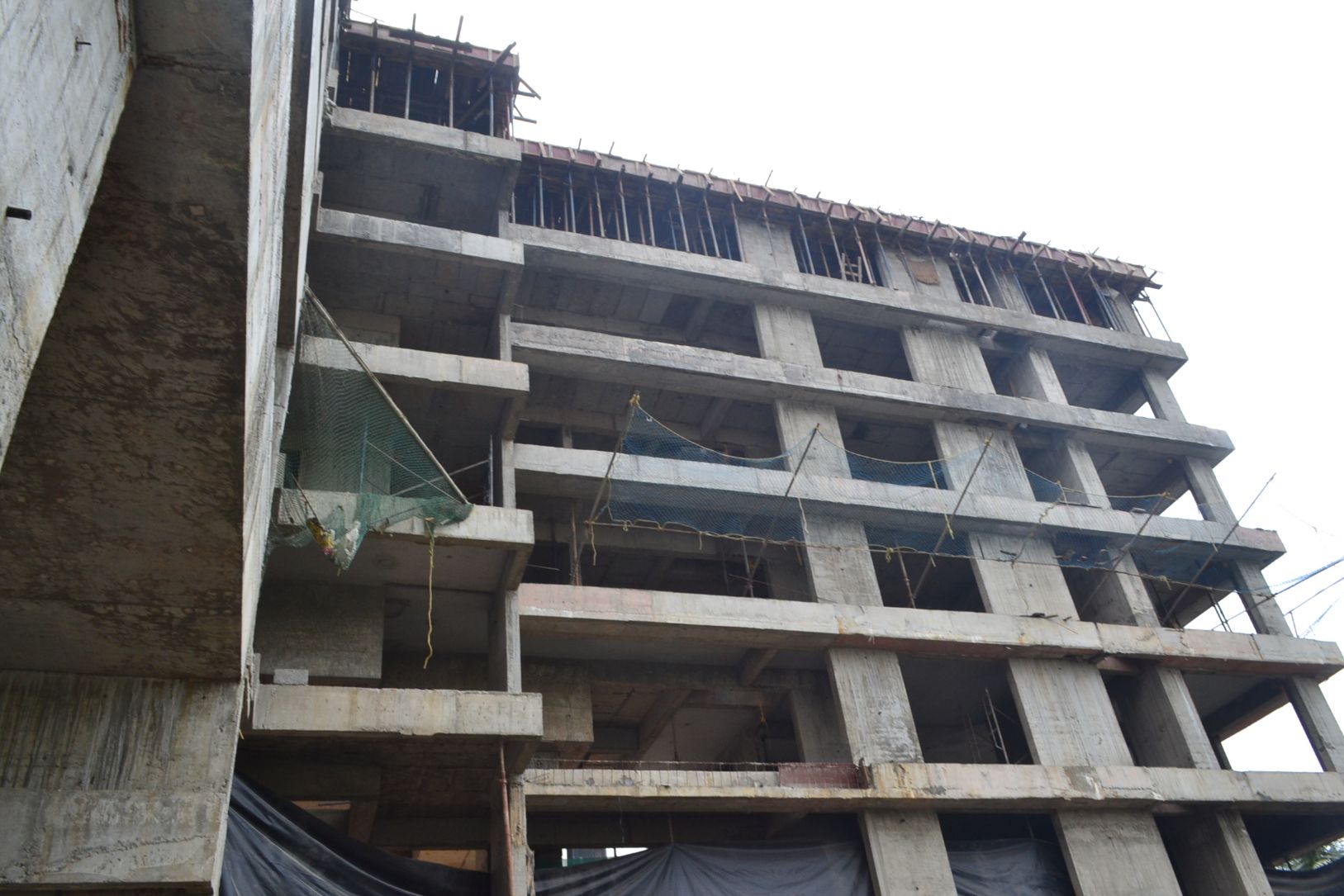

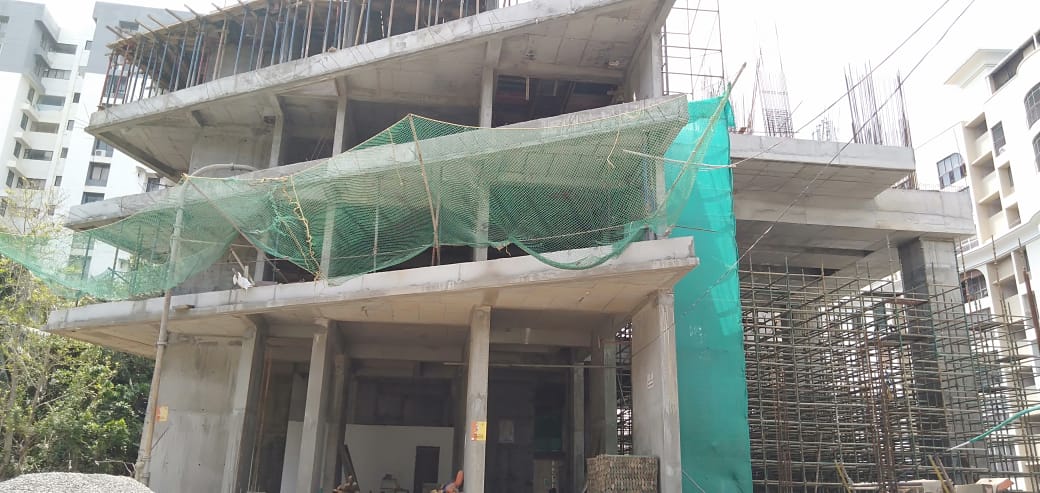

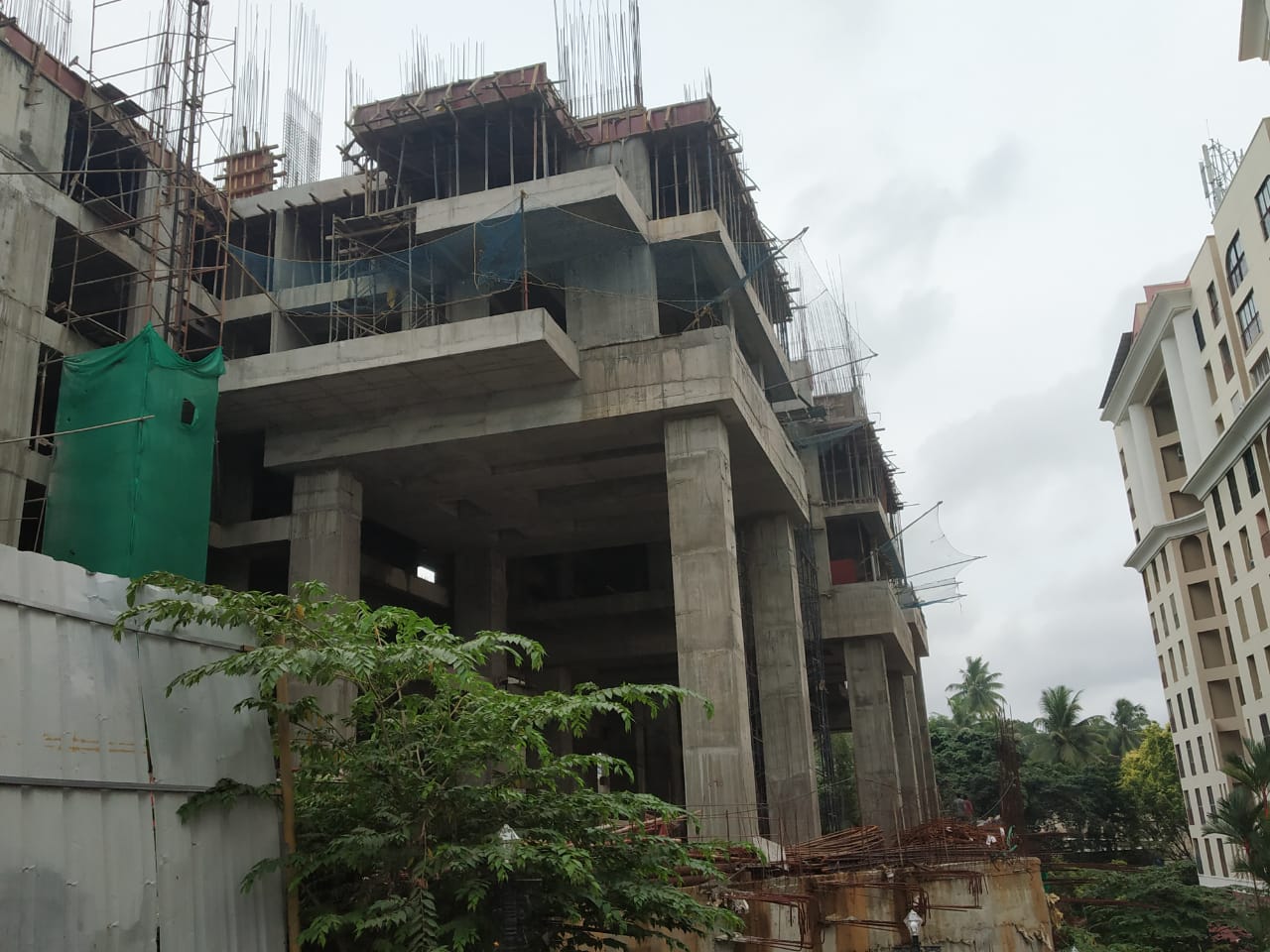

As per the current work status from our site, we are targeted to complete the following works by the end of MARCH 2021.

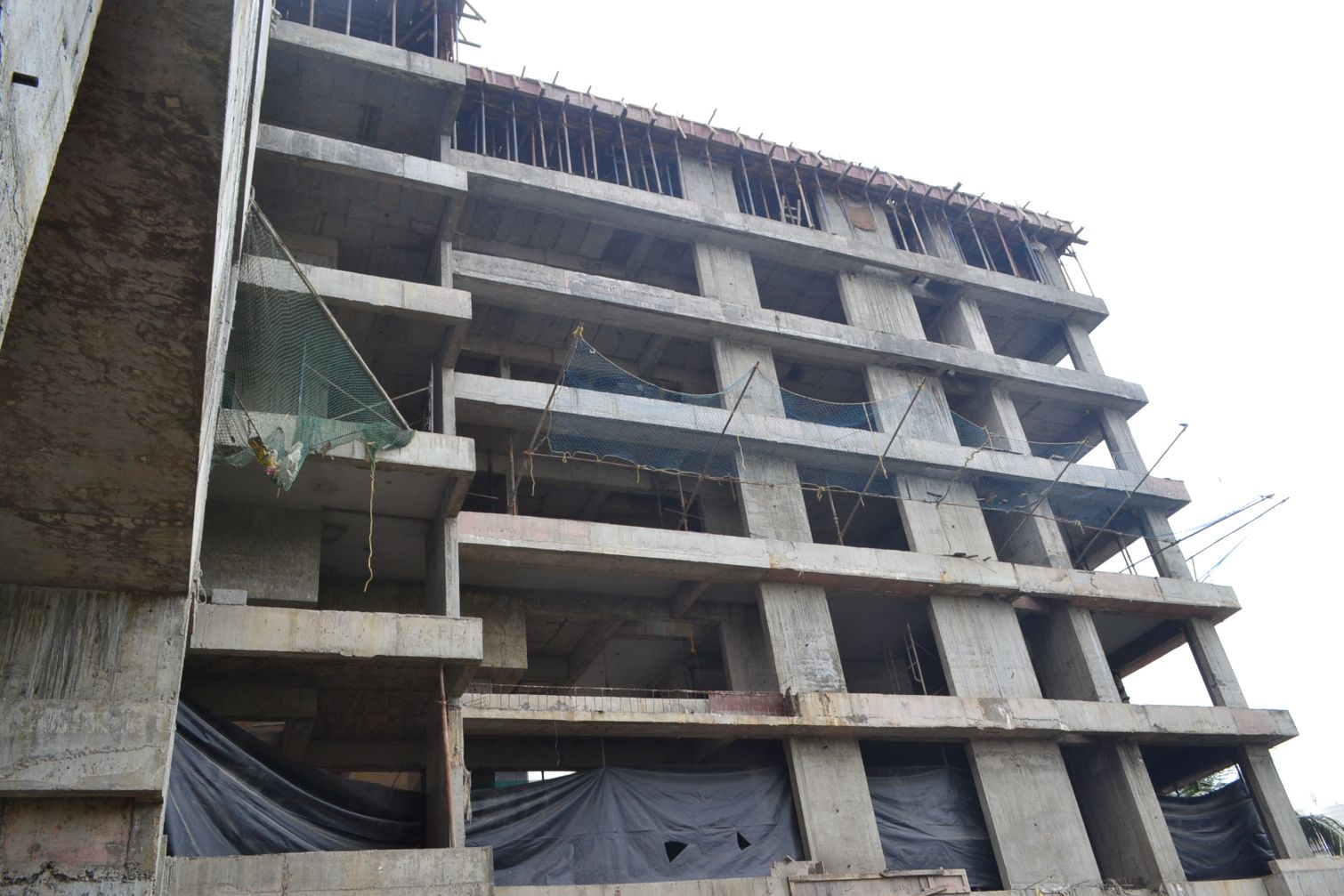

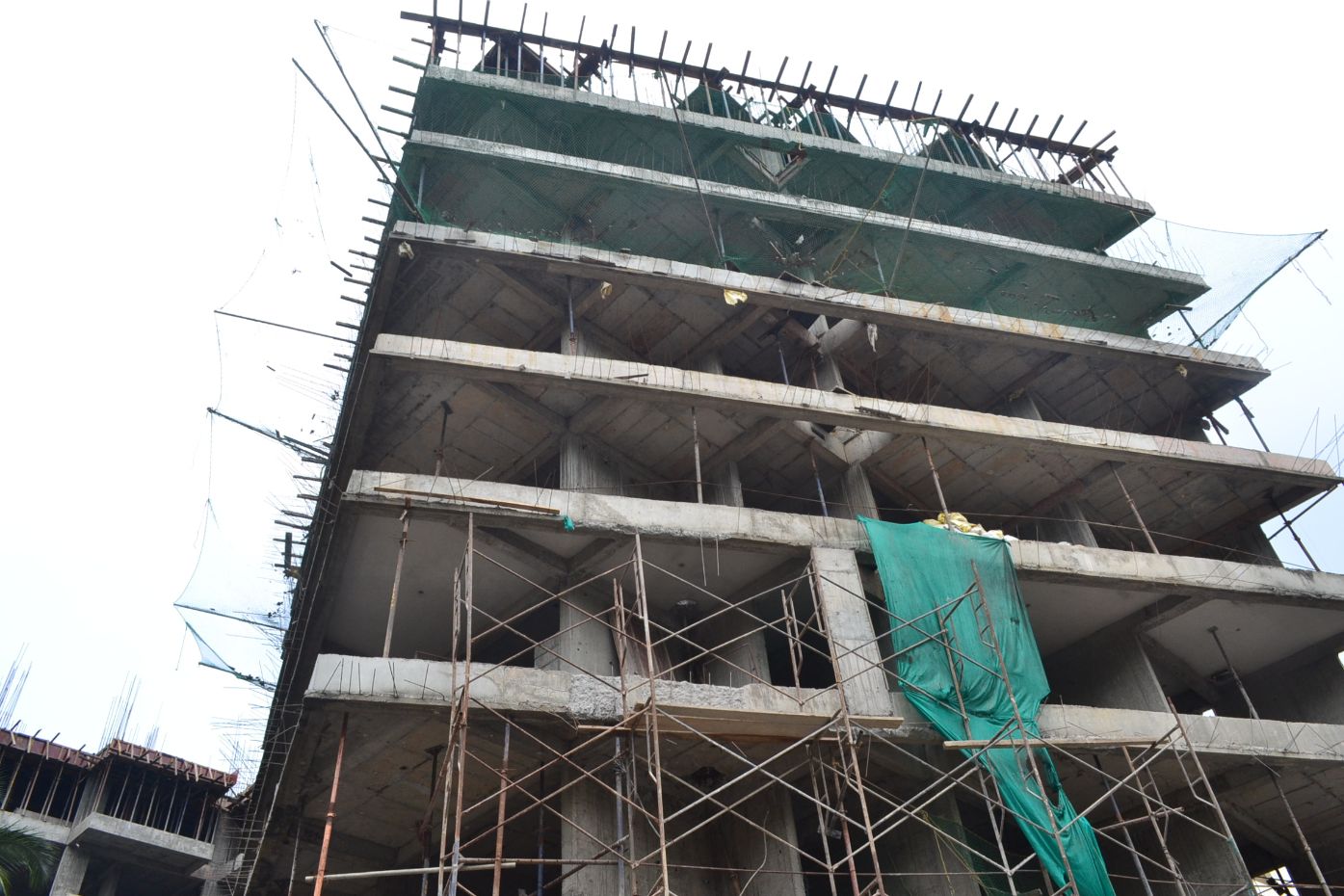

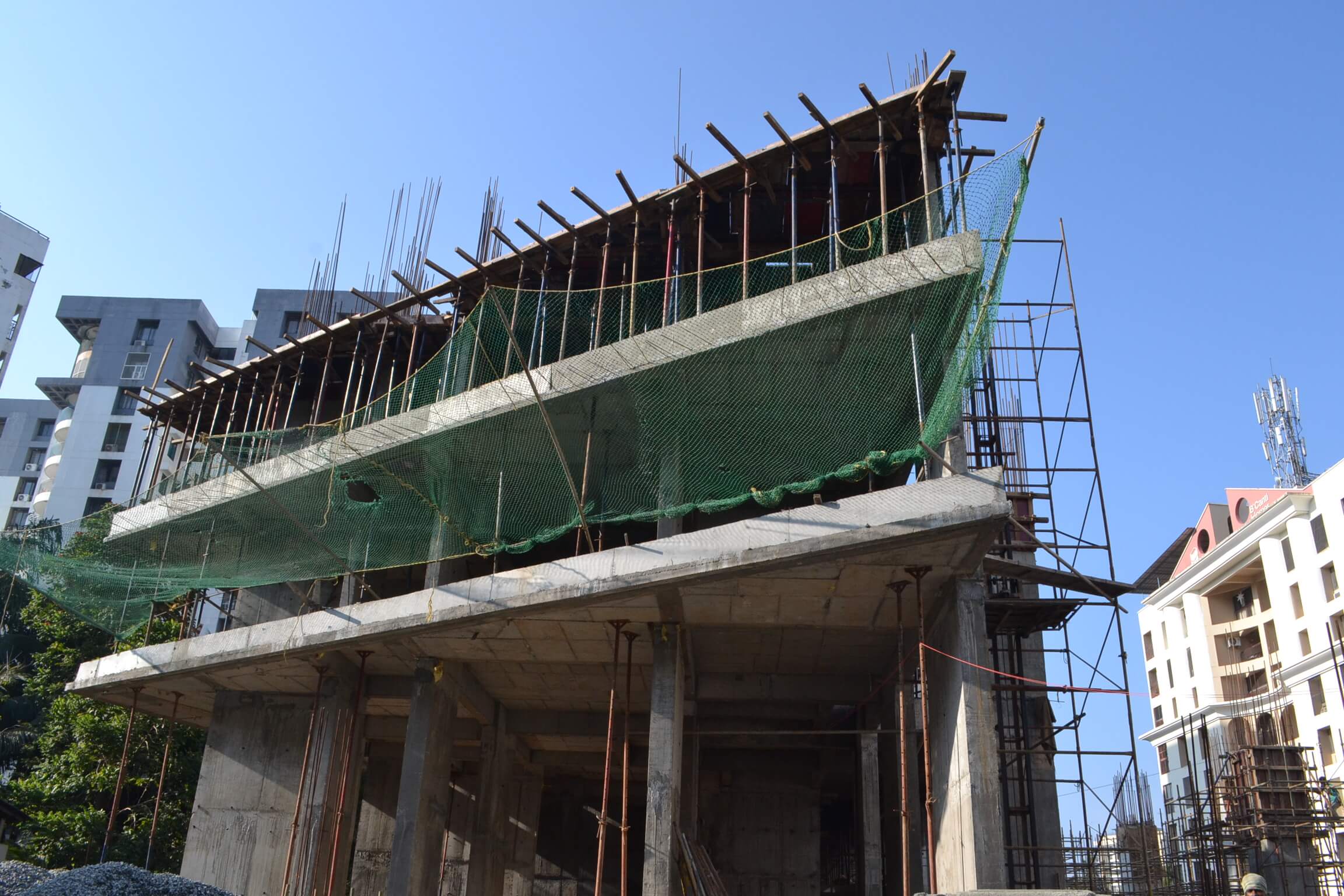

Tower 1

            • Internal wall plastering work -Roof-100% to be completed.

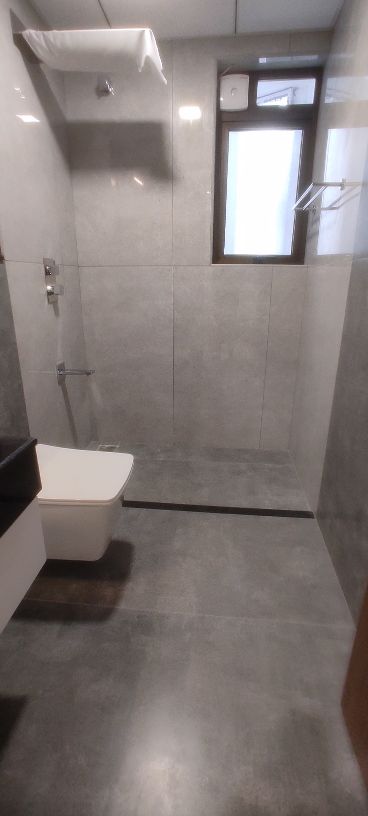

            • Dadoing of toilets:16th floor -100% to be completed
            • Dadoing of kitchen walls:14th floor-100% to be completed,
              16th floor -100% to be completed,
            • Water Proofing work -floor, terrace -100% to be completed
            • External (1st coat) Putty work -at north 85%to be completed.
            • External (2nd coat) Putty work -.at north 85%to be completed.
            • Primer – at north -85% to be completed.
            • Plumbing work -18th floor-100% to be completed
            • Flooring and skirting :-,14th floor- 100% to be completed, 15th floor:- 50% to be completed

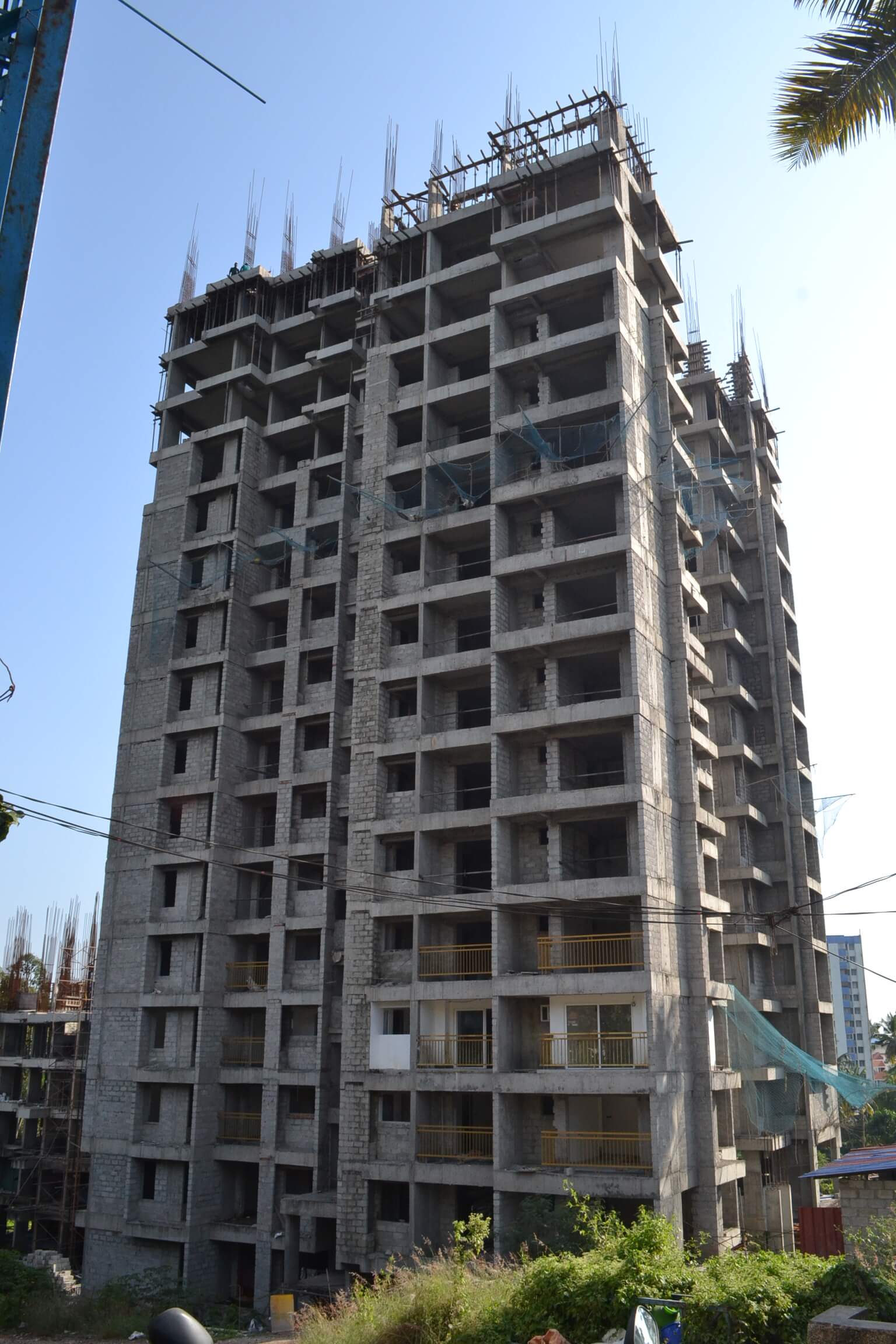

              GF-18th floor- 90% to be completed.

Tower 2

            • RCC for slab -11th roof slab -100% to be completed.,12th-50% to be completed.
            • Ceiling plastering
            • 8th  -100% to be completed
            • Electrical Wall Chasing
            • 5th floor :-100% to be completed.
            • Wall Plastering
            • 3rd floor :-100% to be completed.
            • Block Work
            • BF2:-100% to be completed.
            • 6th floor -100% to be completed.
            • Yardwork: full side retaining wall-50% to be completed.

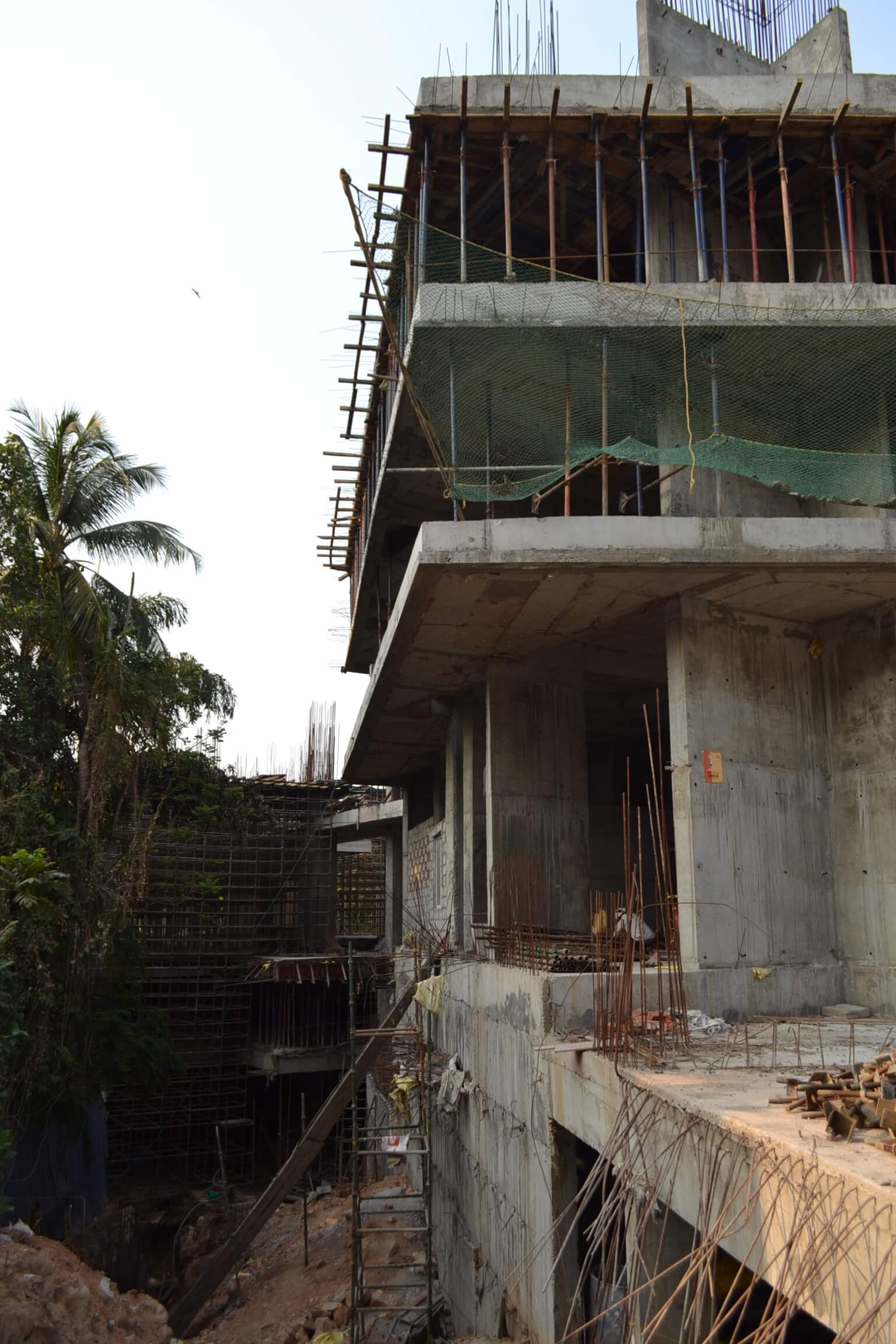

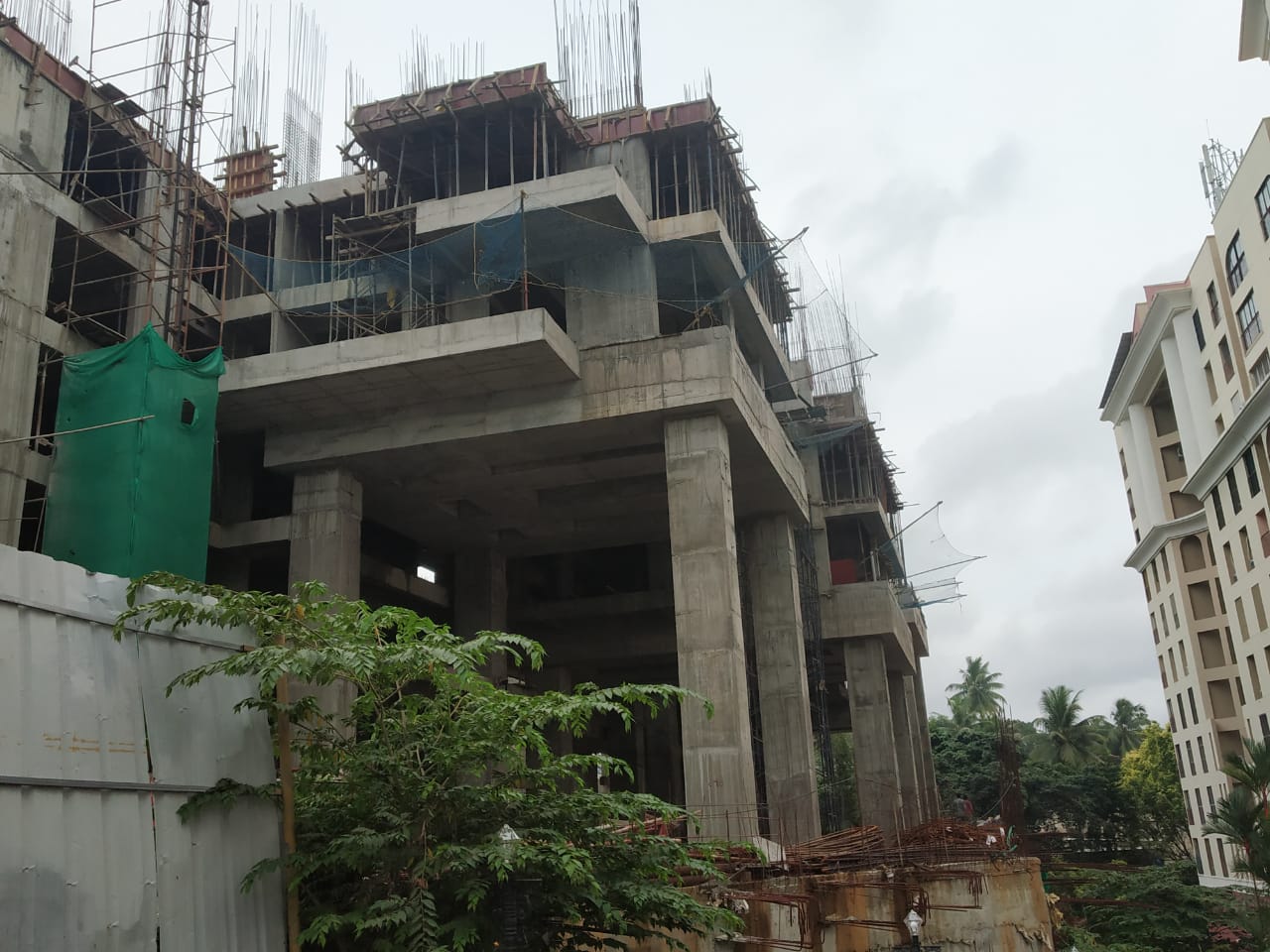

As per the current work status from our site, we are targeted to complete the following works by the end of February 2021

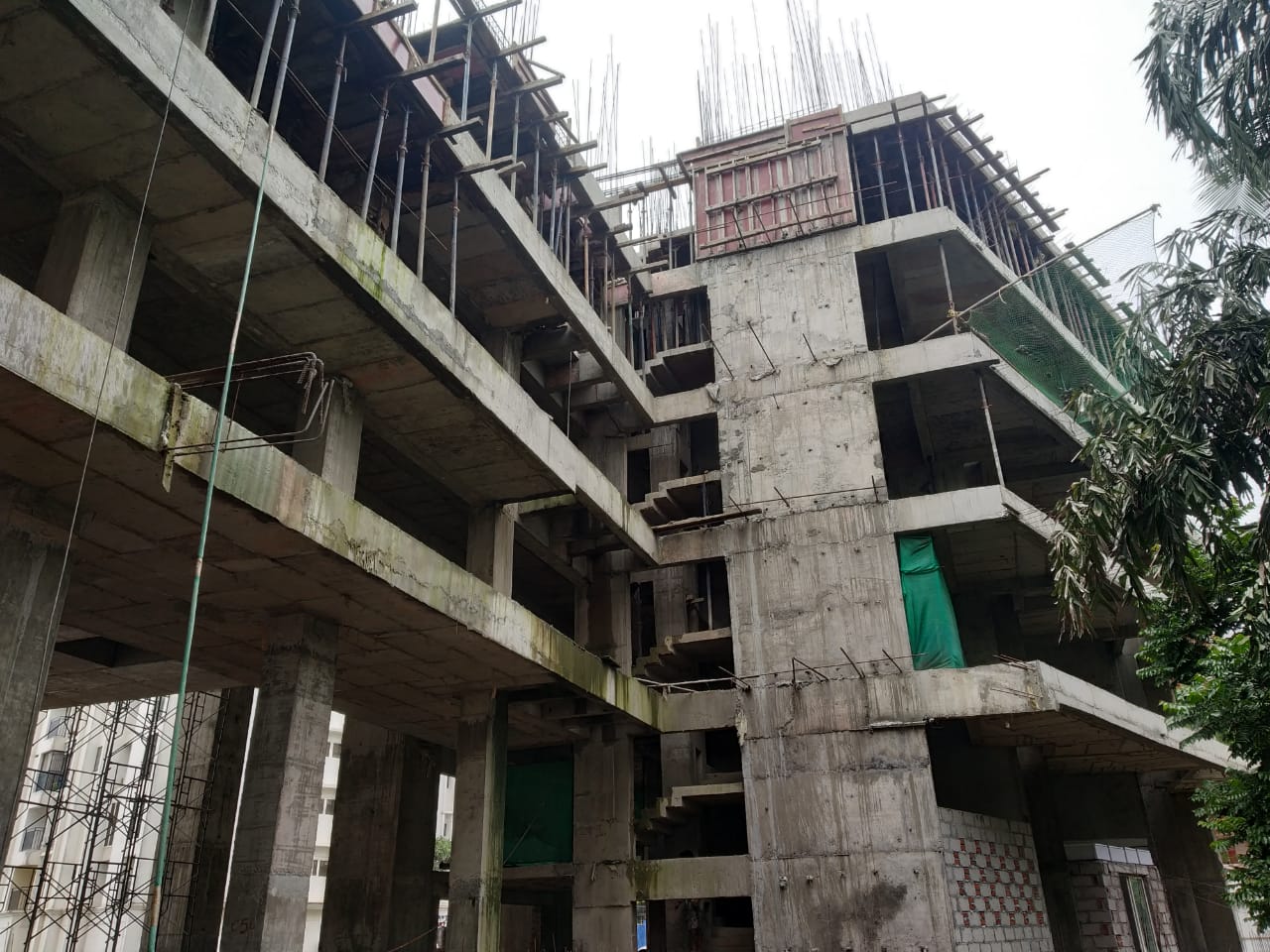

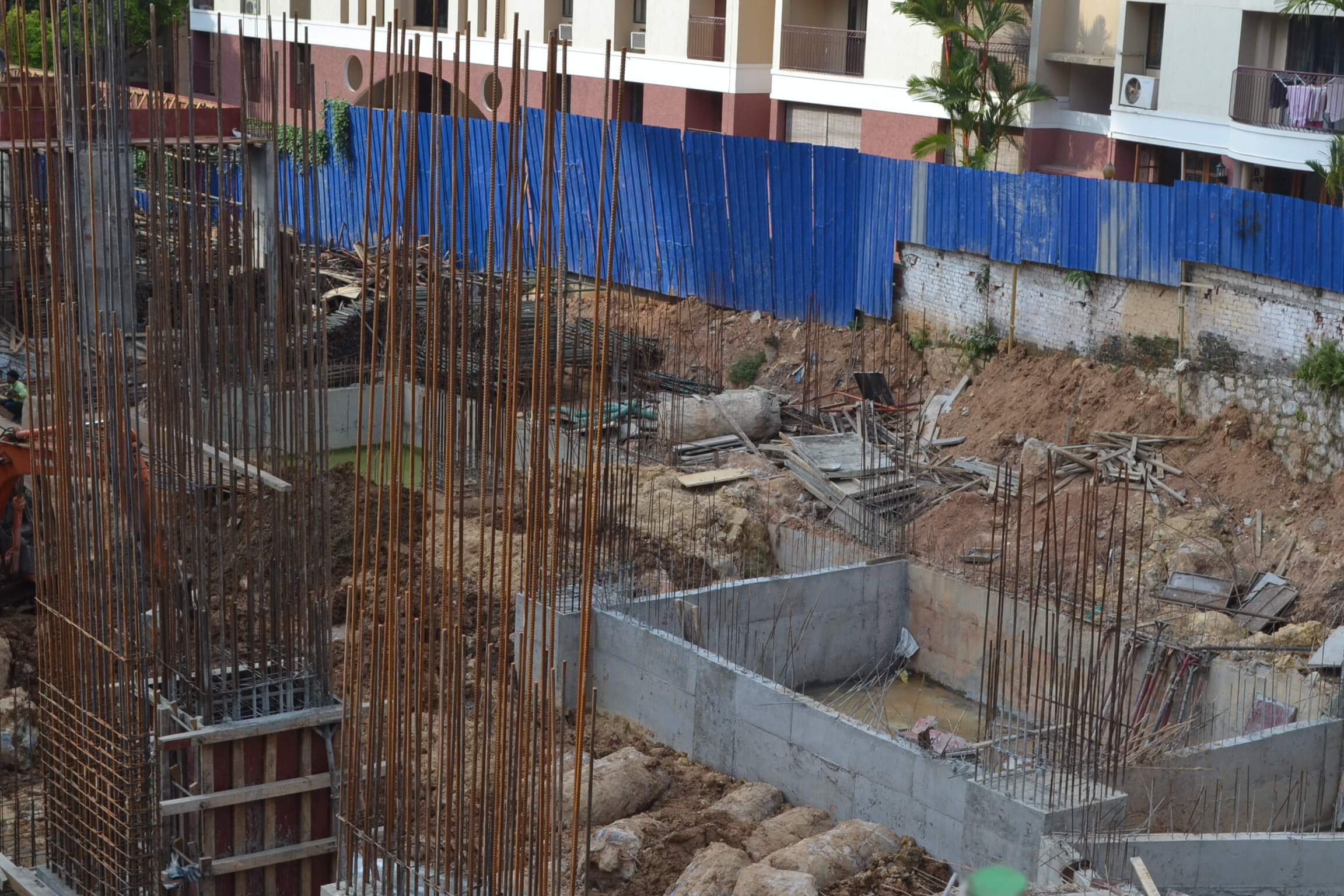

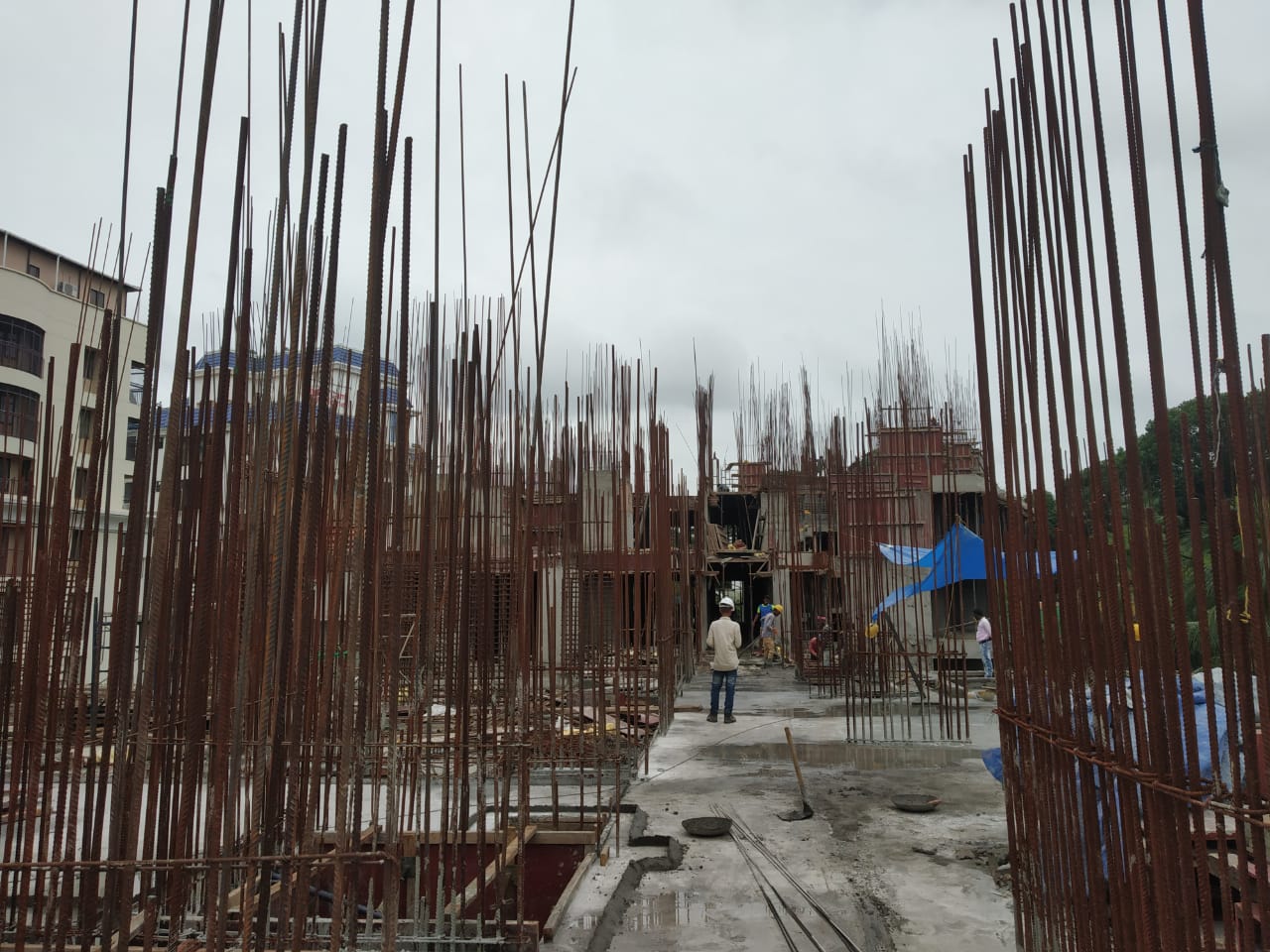

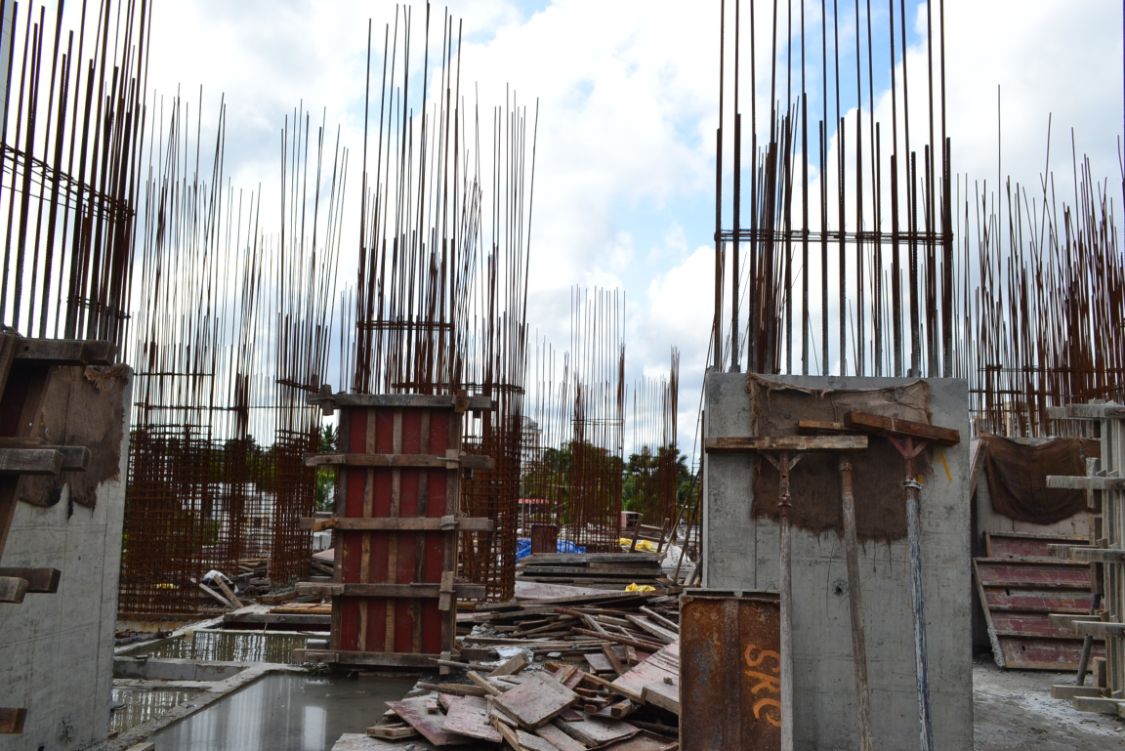

            • RCC for slab: 11th floor-100% to be completed.
            • Column work: 10th floor – 100% to be completed
            • Rcc for Retaining wall: Base floor2-25% to be completed.
            • RCC for Ramp: BF2- 100% to be completed, BF1- 60% to be completed
            • Ceiling: 9th floor:-50% to be completed
            • Wall plastering: 2ndfloor – 25% to be completed
            • Blockwork: 5th floor:-50% to be completed

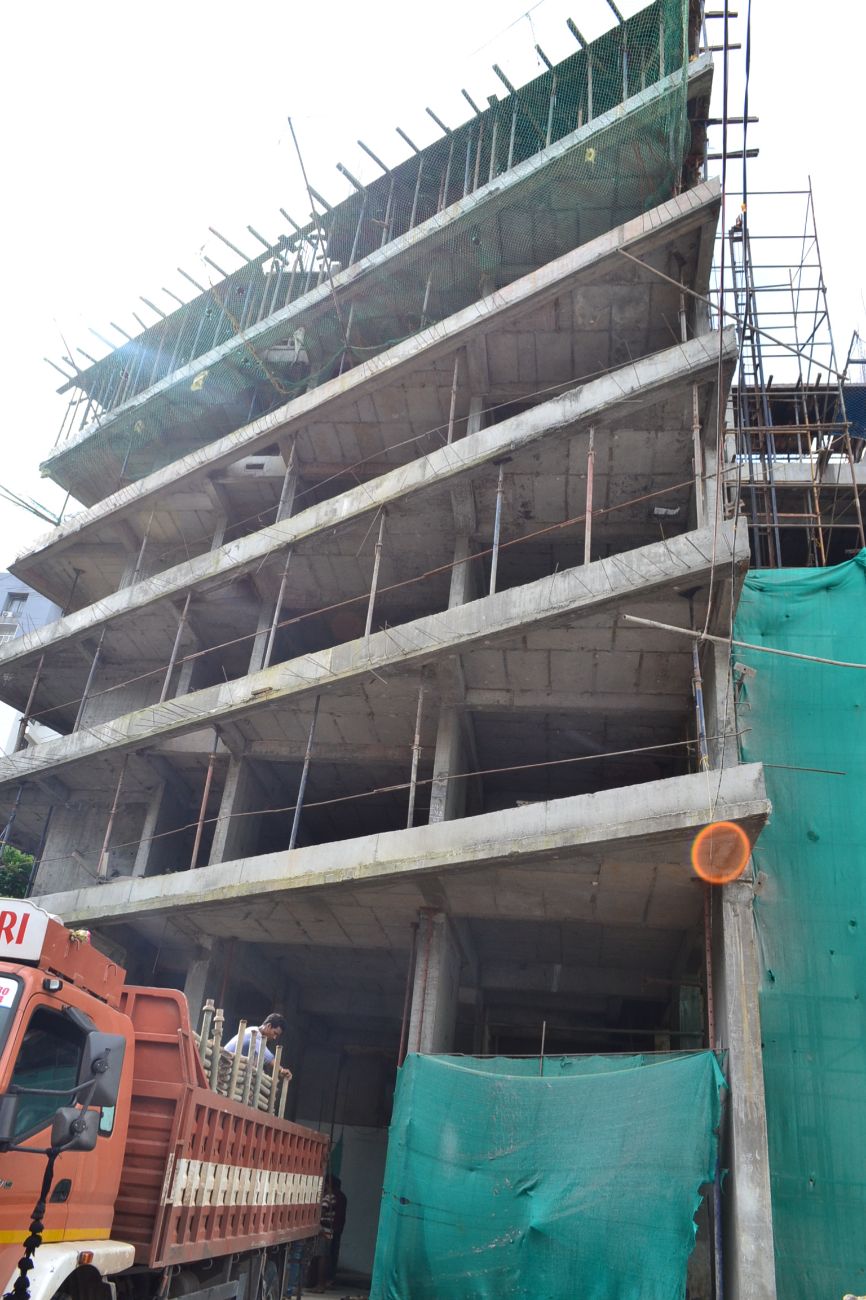

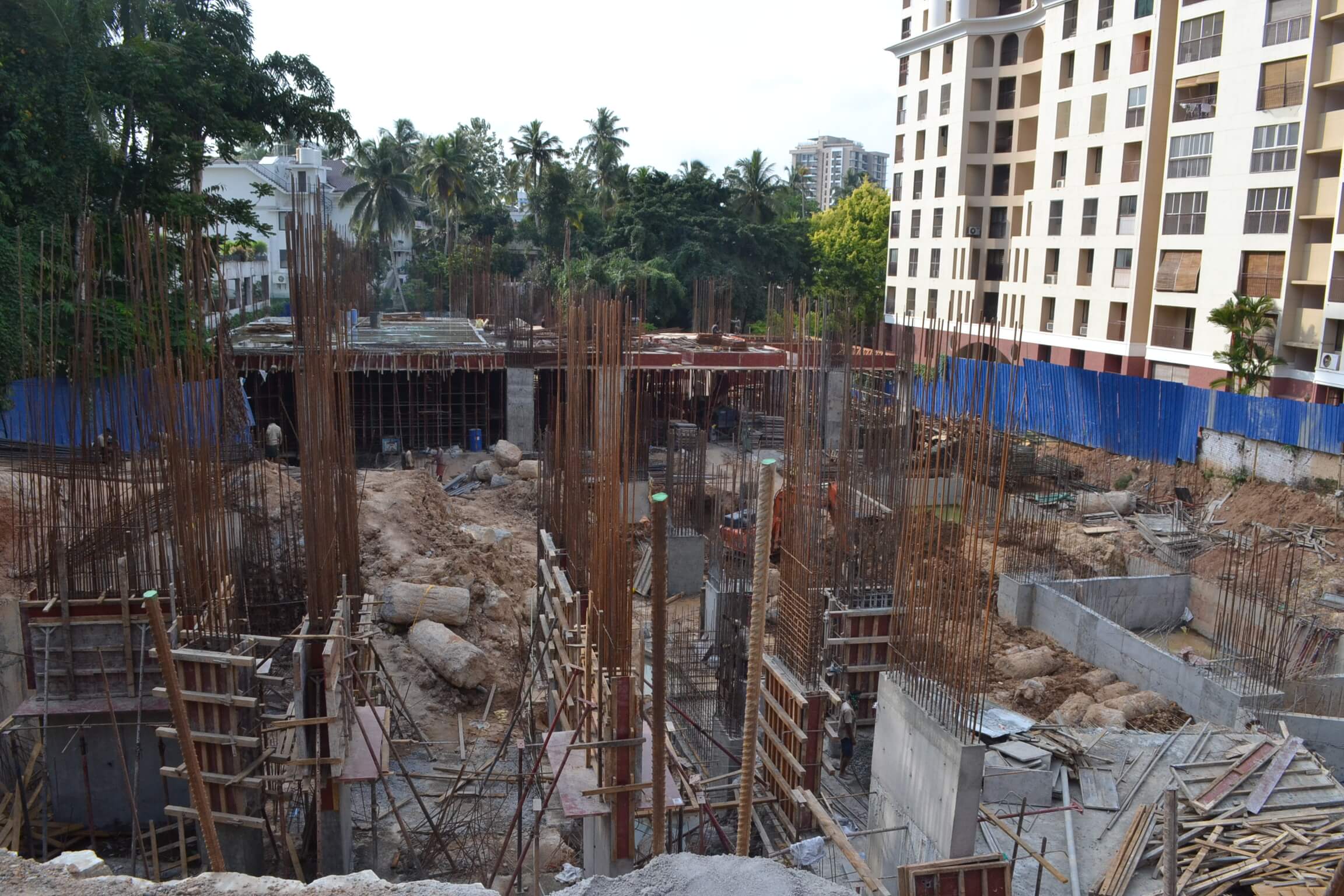

Work status as on 09-02-2021, we have completed the following.

            • Earthwork – 90% completed
            • Pile chipping work – completed
            • Pile cap work -92% completed

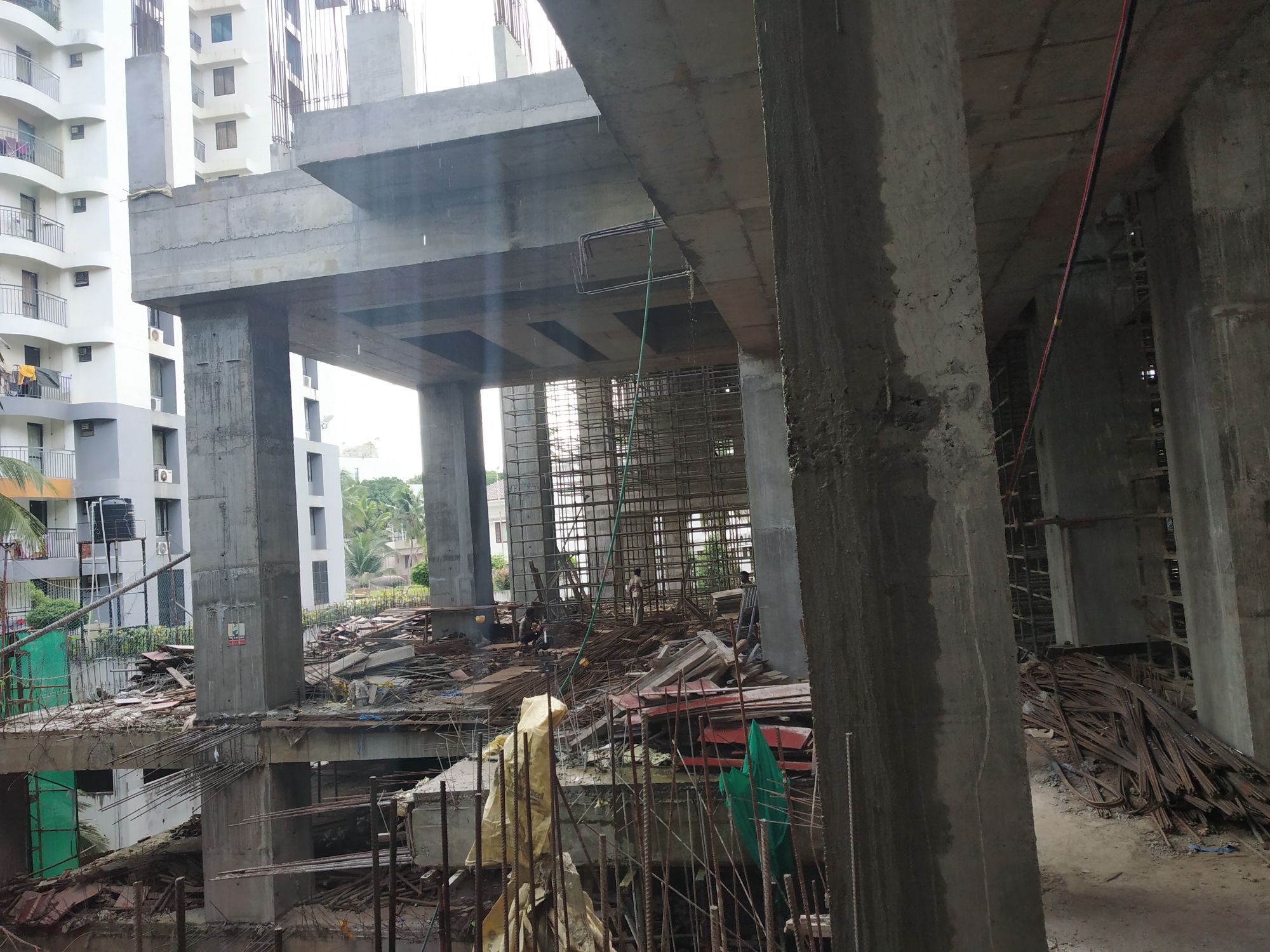

            • RCC for slab: BF2-10th floor slab-RCC work 100% completed
            • Column work : BF2 – 9 th floor -100% completed ,10th floor -45% completed, RCC for ramp, BF1,BF2 :80% completed,
            • RCC for Ramp: BF2- 60% completed, BF1- 30% completed
            • Ceiling Plastering: 1st floor:- 70% completed
            • Ceiling Plastering (2nd floor-8th floor ):90% completed
            • wall plastering: 2ndfloor – 20% completed
            • Block work: 2ndfloor -3rd floor-75% completed, 4th floor -90% completed,5th floor – 10% completed.

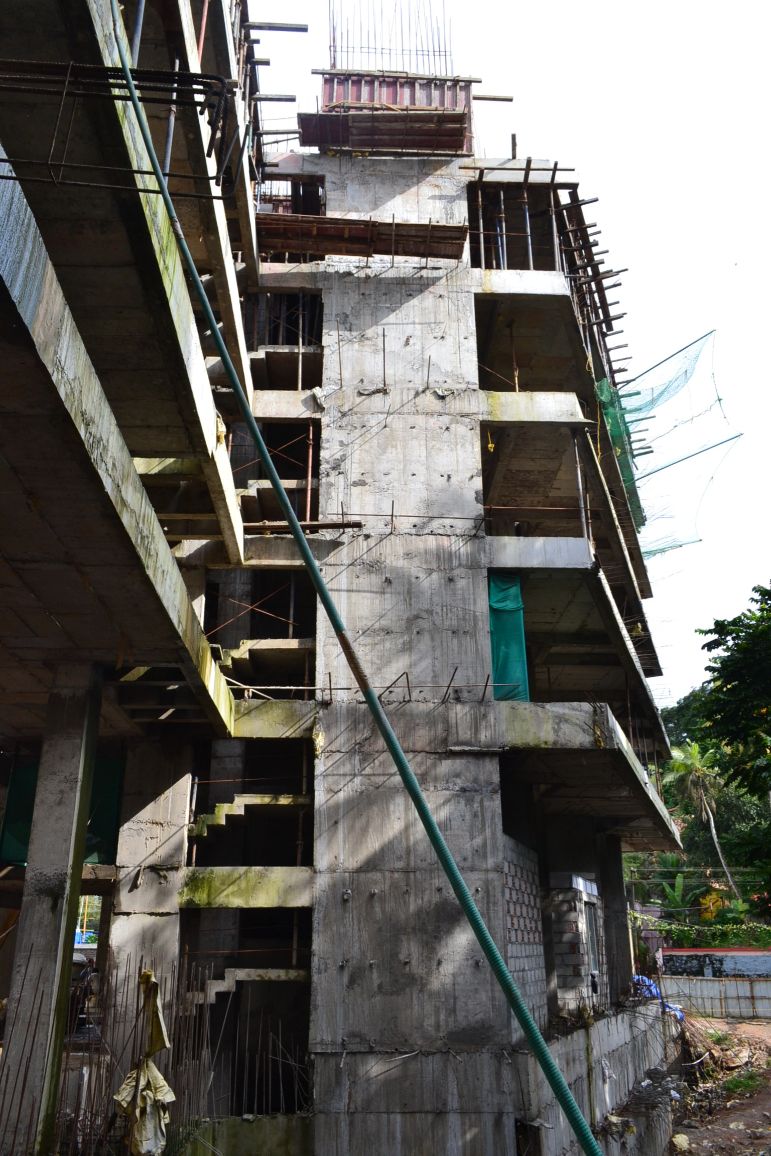

As per the current work status from our site, we are targeted to complete the following works by the end of JANUARY 2021

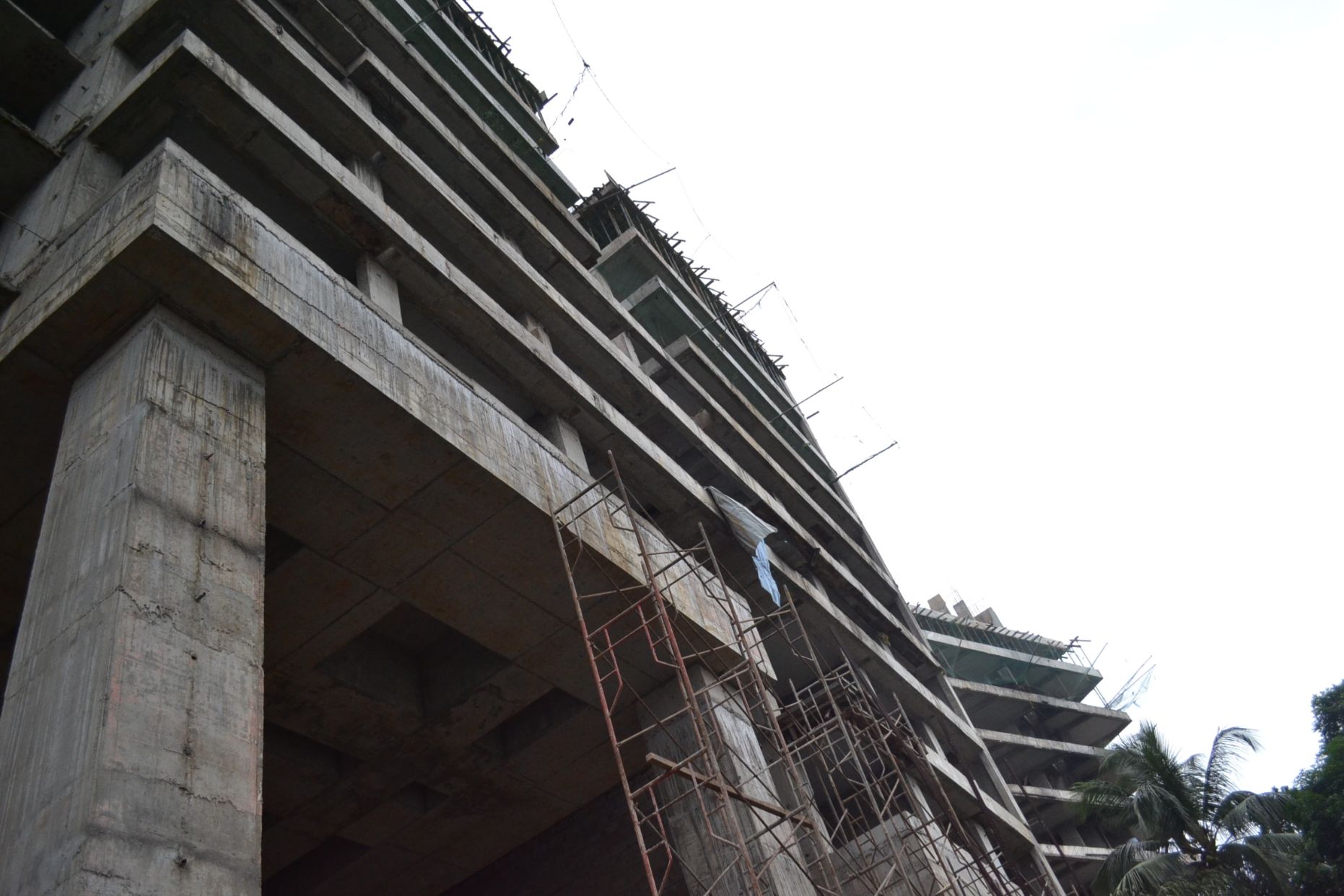

RCC for slab

            • 11th floor-100% to be completed.

Column work :

            • 10th floor – 70% to be completed

Rcc for Retaining wall

            • Base floor2-25% to be completed.

RCC for Ramp

            • BF2- 100% to be completed, BF1- 30% to be completed

Ceiling

            • 9th floor:-50% to be completed

Wall plastering

            • 2ndfloor – 25% to be completed

Blockwork

            • 4th floor:- 100% to be completed

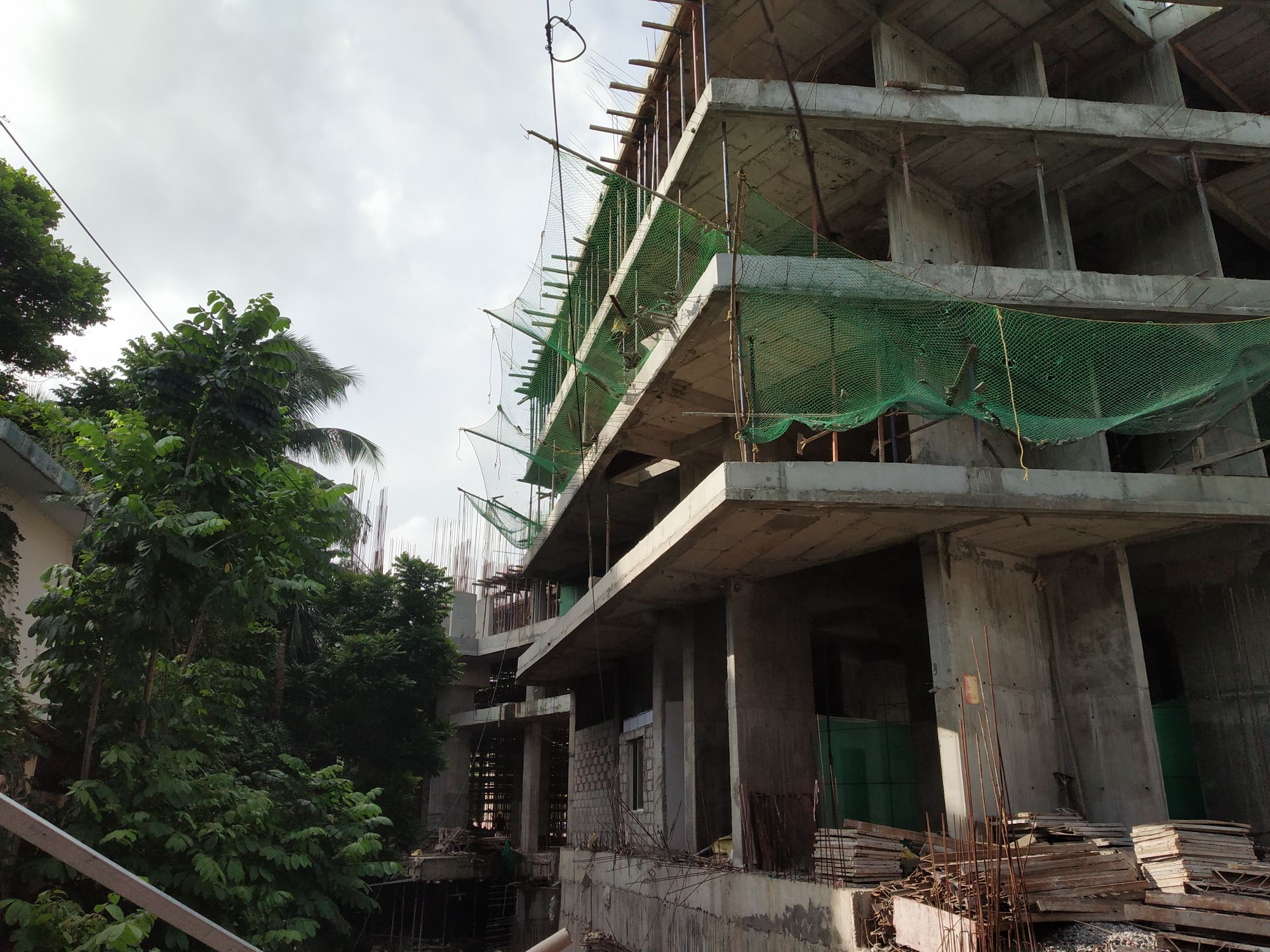

Work status as on 07-01-2021, we have completed the following.

            • Earth work – 90% completed
            • Pile chipping work – completed
            • Pile cap work -92% completed

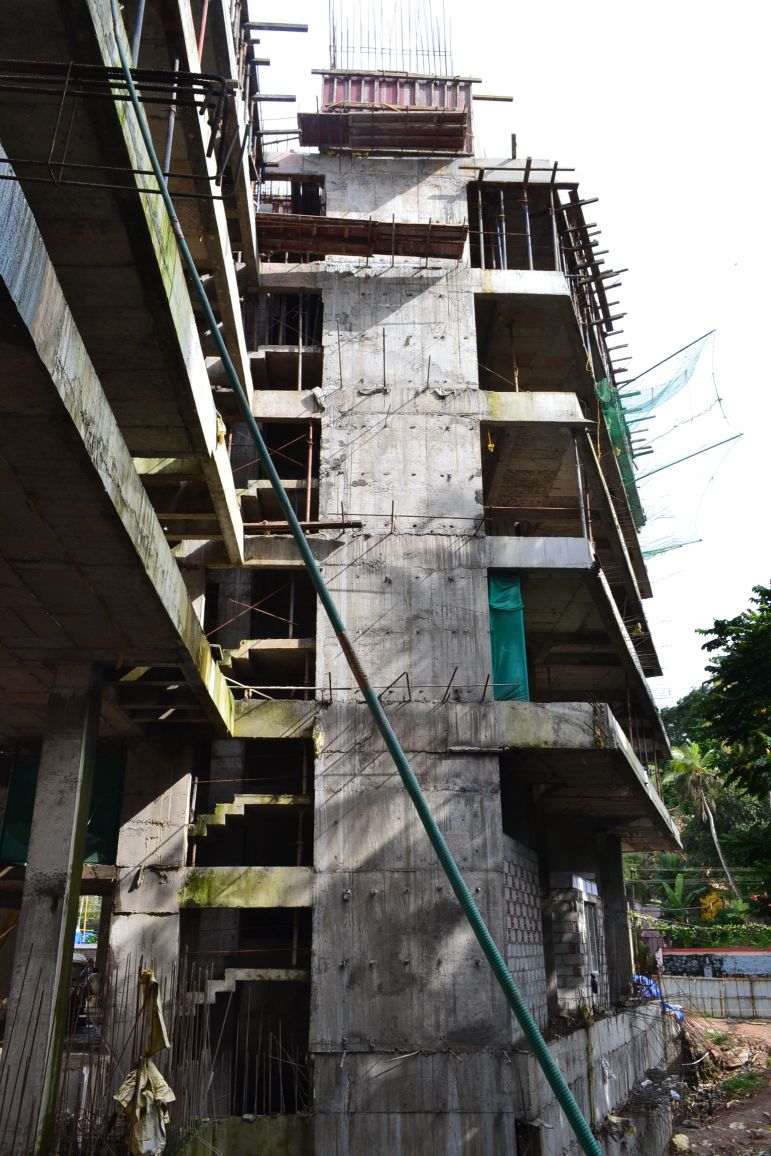

RCC for slab

            • BF2-10th floor slab -RCC work 100% completed

Column work :

            • BF2 – 9 th floor -100% completed
            • RCC for ramp, BF2 :50% completed

RCC for Ramp

            • BF2- 60% completed, BF1- 30% completed

Ceiling

            • Ceiling Plastering (2nd floor-8th floor ):90% completed, 1st floor:- 70% completed

wall plastering

            • 2ndfloor – 20% completed

Block work

            • 2ndfloor – 50% completed,3rd floor-25% to be completed, 4th floor -80% completed.

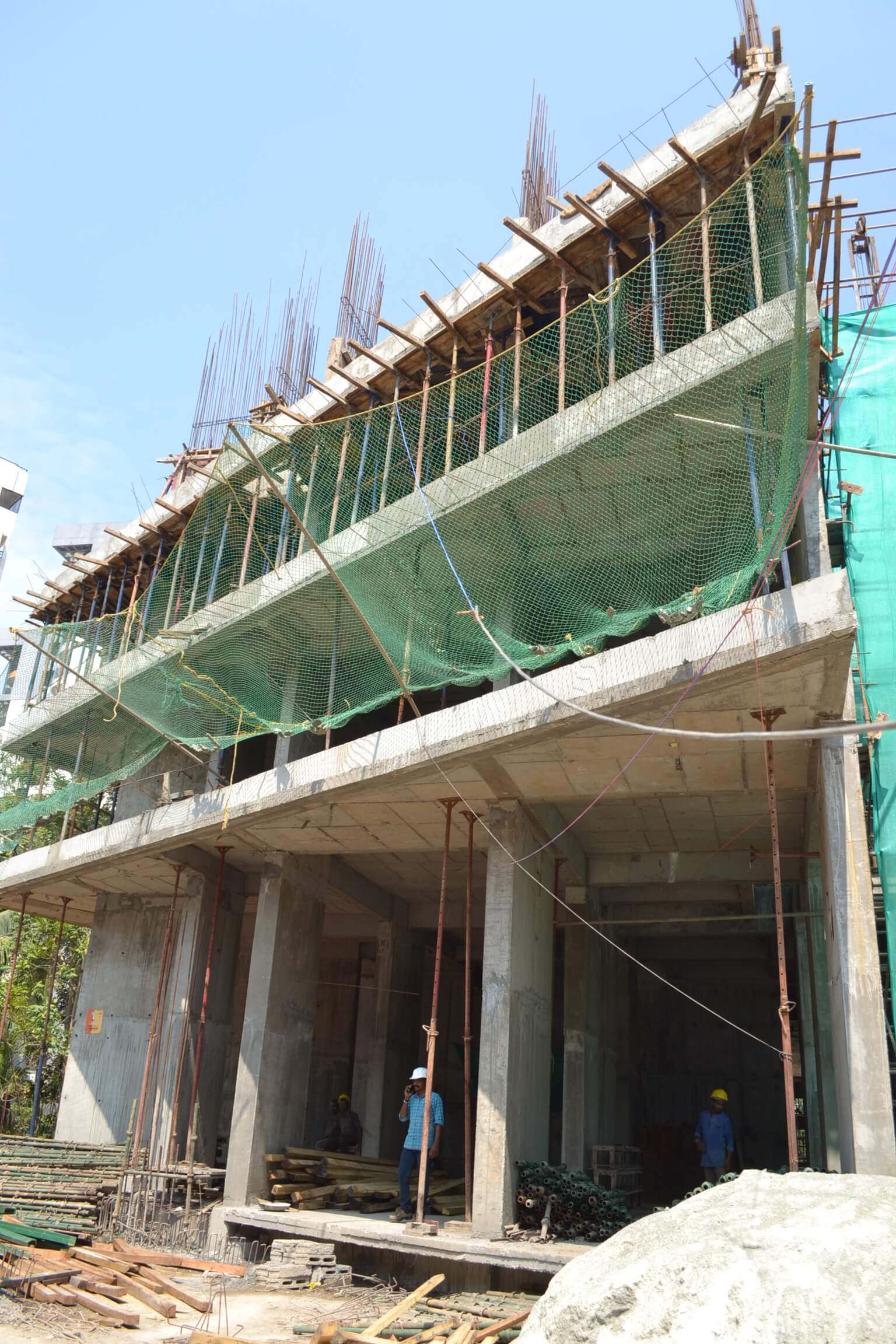

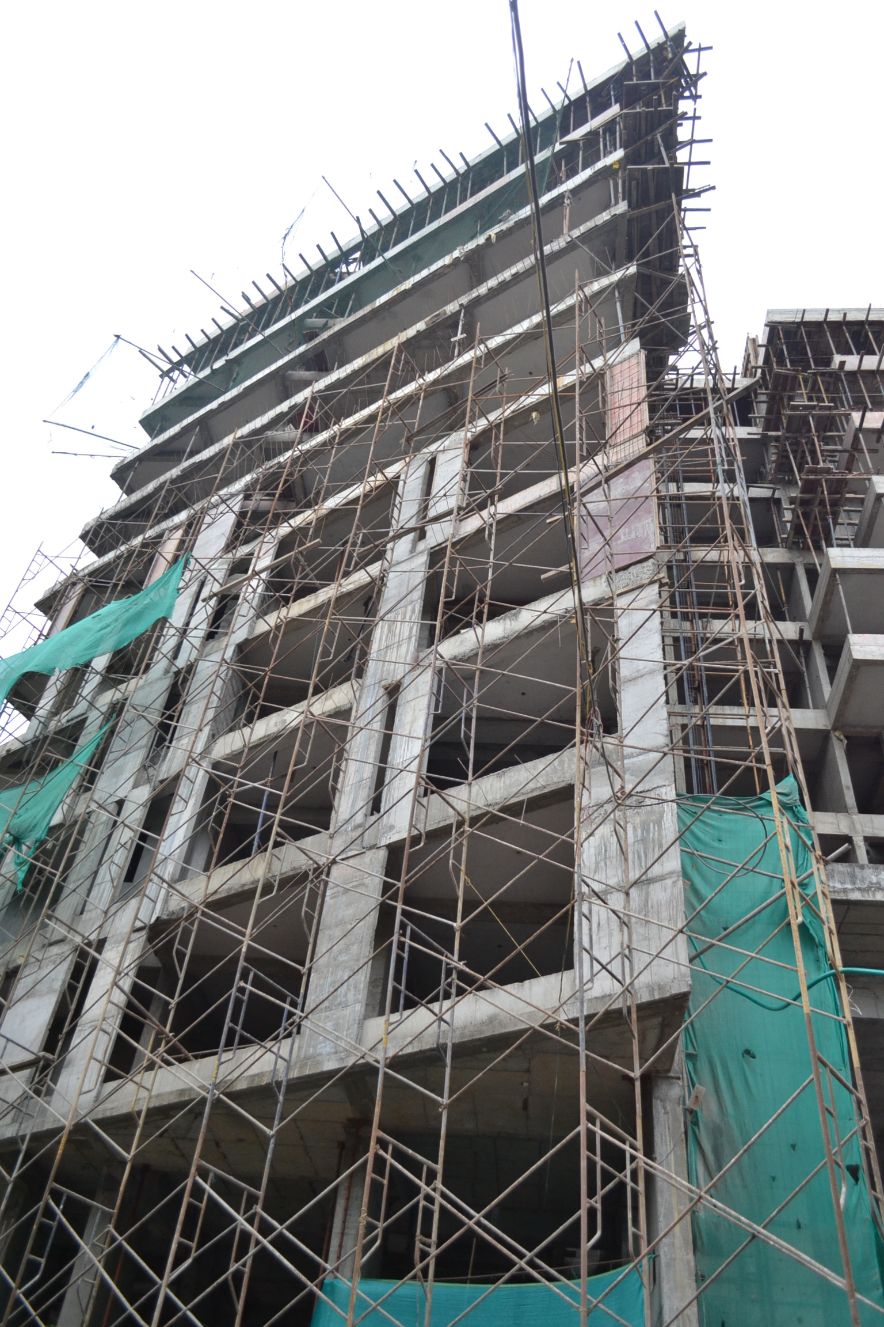

As per the current work status from our site, we are targeted to complete the following works by the end of July 2020
RCC for slab

            • 8th floor -90% to be completed.

Column work :

            • 8th floor -20% to be completed.

Ceiling

            • Third floor:-100% to be completed,Fourth floor:-90% completed.

Block work

            • Second floor:50% Completed

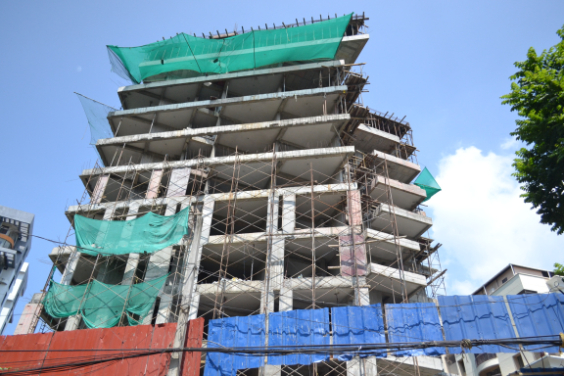

Work status as on June, we have completed the following.

            • Earth work – 90% completed
            • Pile chipping work – 319 nos completed (out of 323)
            • Pile cap work -92% completed

RCC for slab

            • BF2-7th floor slab -RCC work 100% completed

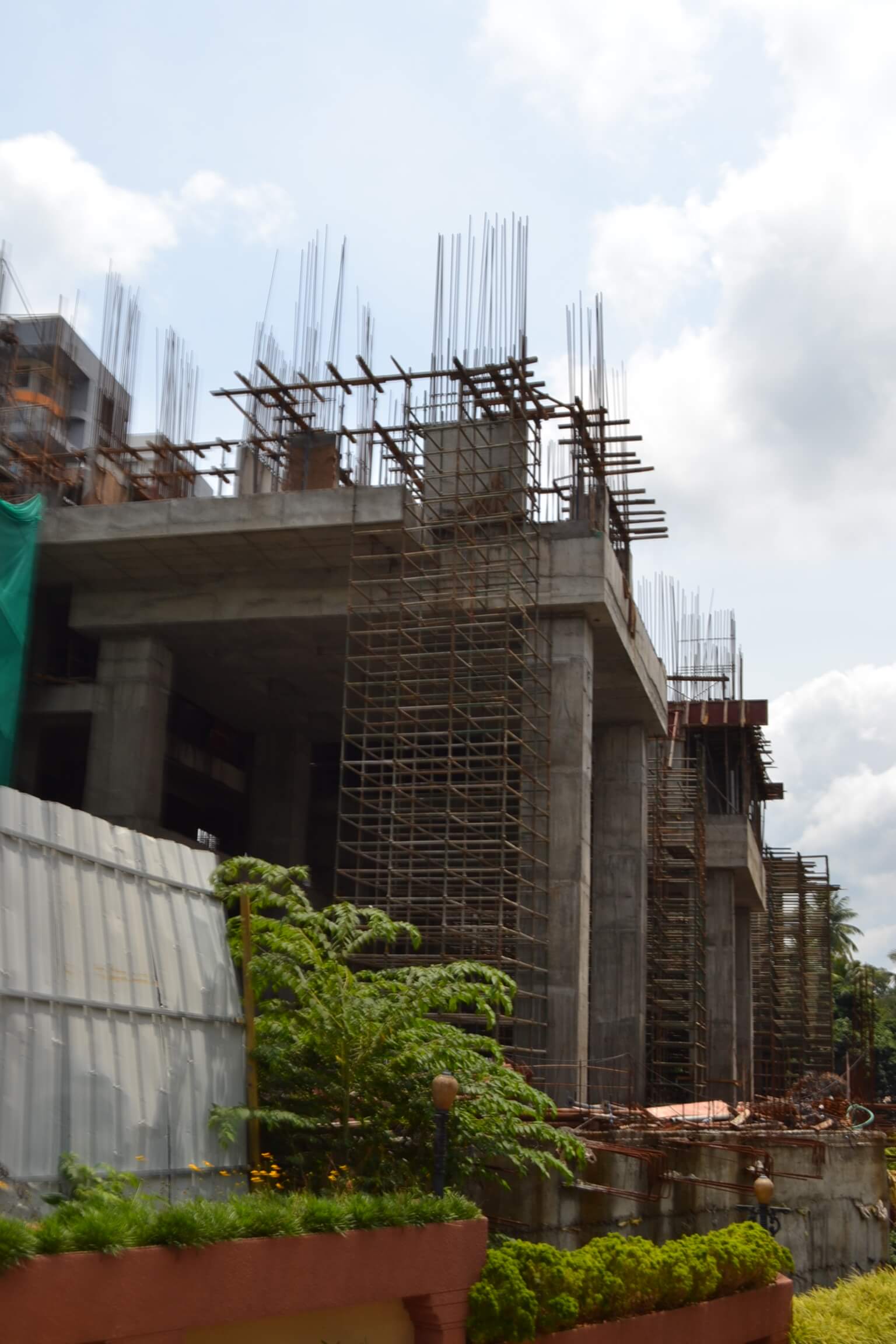

            • 8th floor slab -RCC work 60% completed

Column work :

            • BF2 – 6 th floor -100% completed.
            • 7 th floor -85% completed .
            • RCC for ramp, BF2 :35% completed

Ceiling

            • Ceiling Plastering (2nd floor ):90% completed (3rd floor); 90% completed, forth floor :- 35% completed.

Block work

            • Second floor:10% Completed

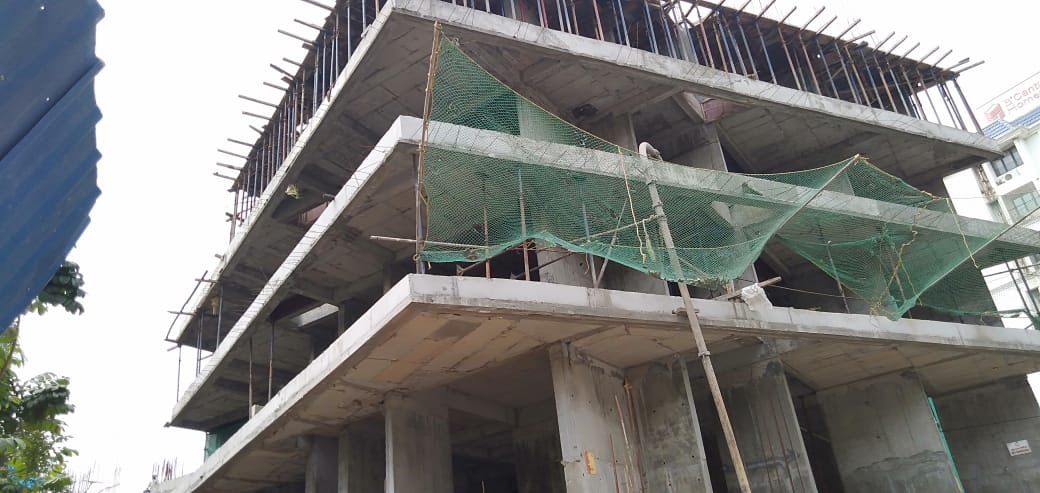

As per the current work status from our site, we are targeted to complete the following works by the end of March 2020

            • Rcc for slab upto 8th floor -100% to be completed.
            • Column work : 7th-100% to be completed, 8th floor – 30% to be completed
            • Ceiling: Second floor :100% to be completed, Third floor;100% to be completed.
            • Block work: Second floor:50% to be Completed

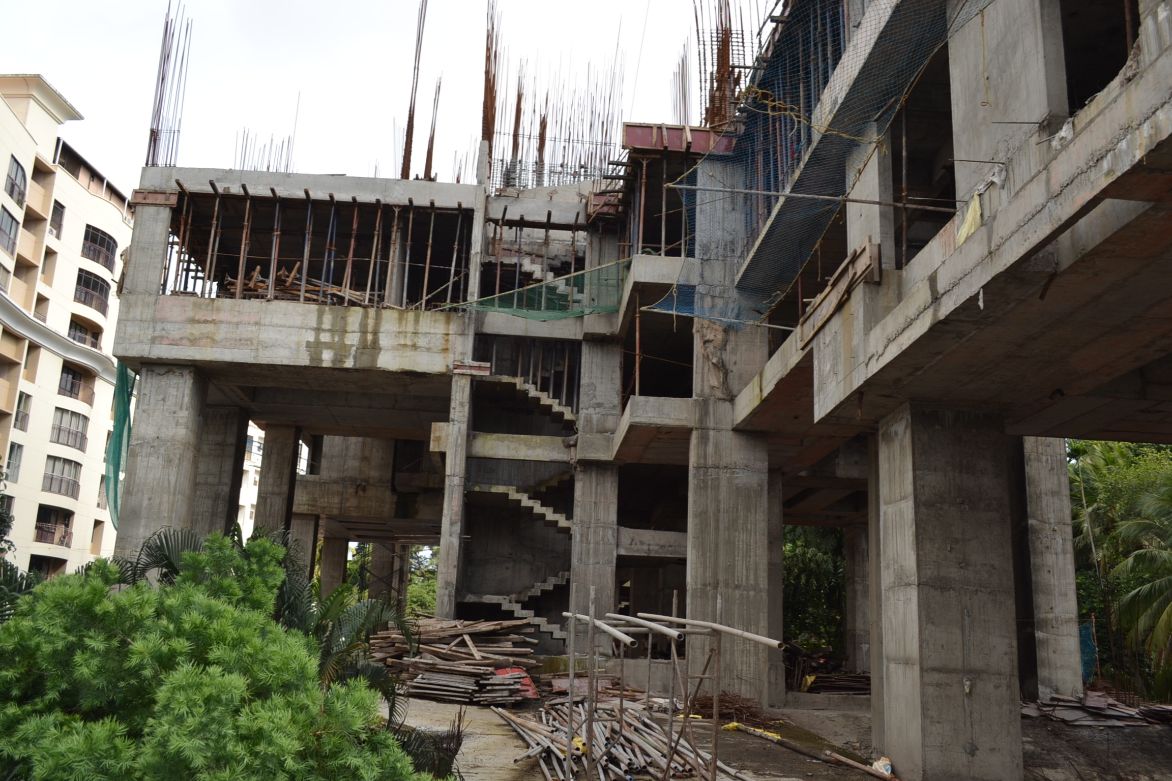

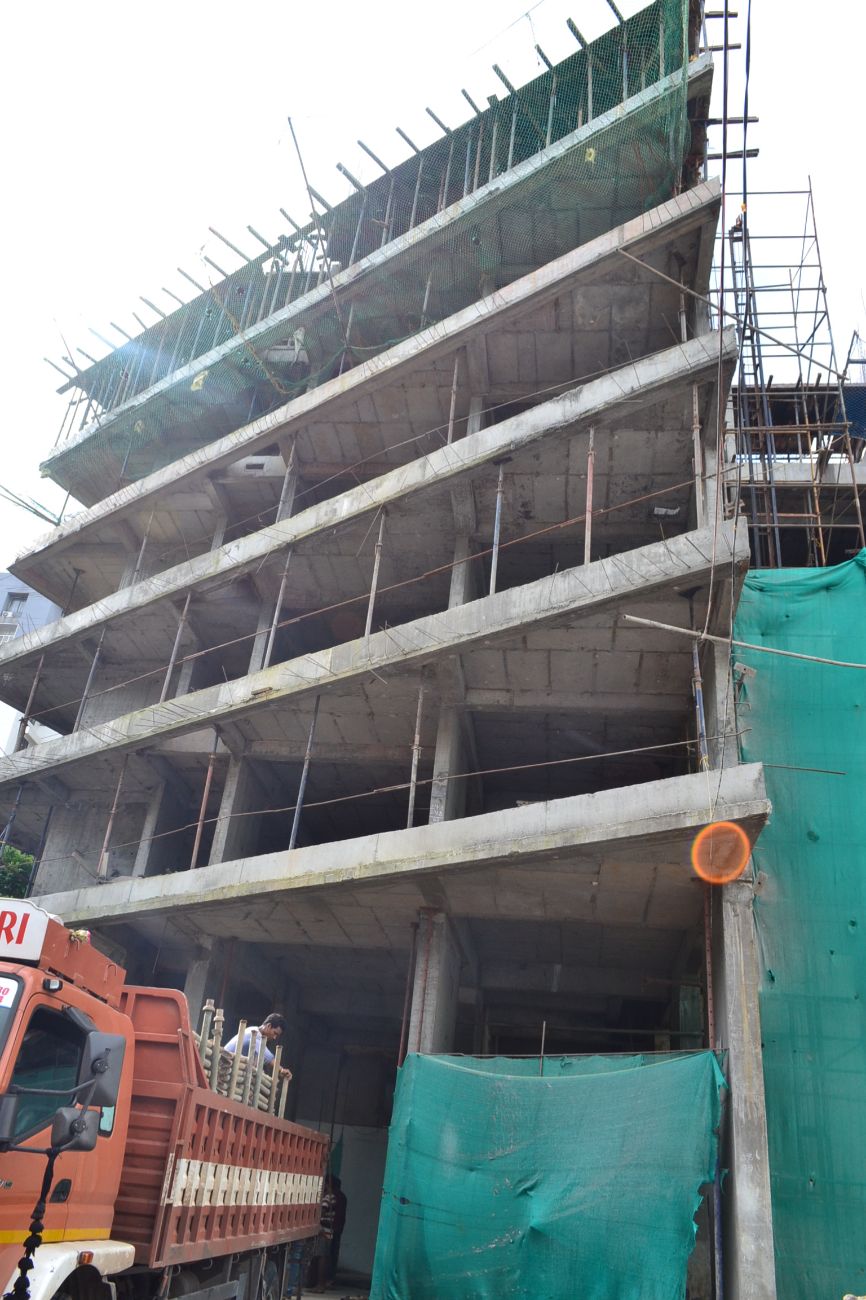

Work status as on 11-03-2020, we have completed the following.

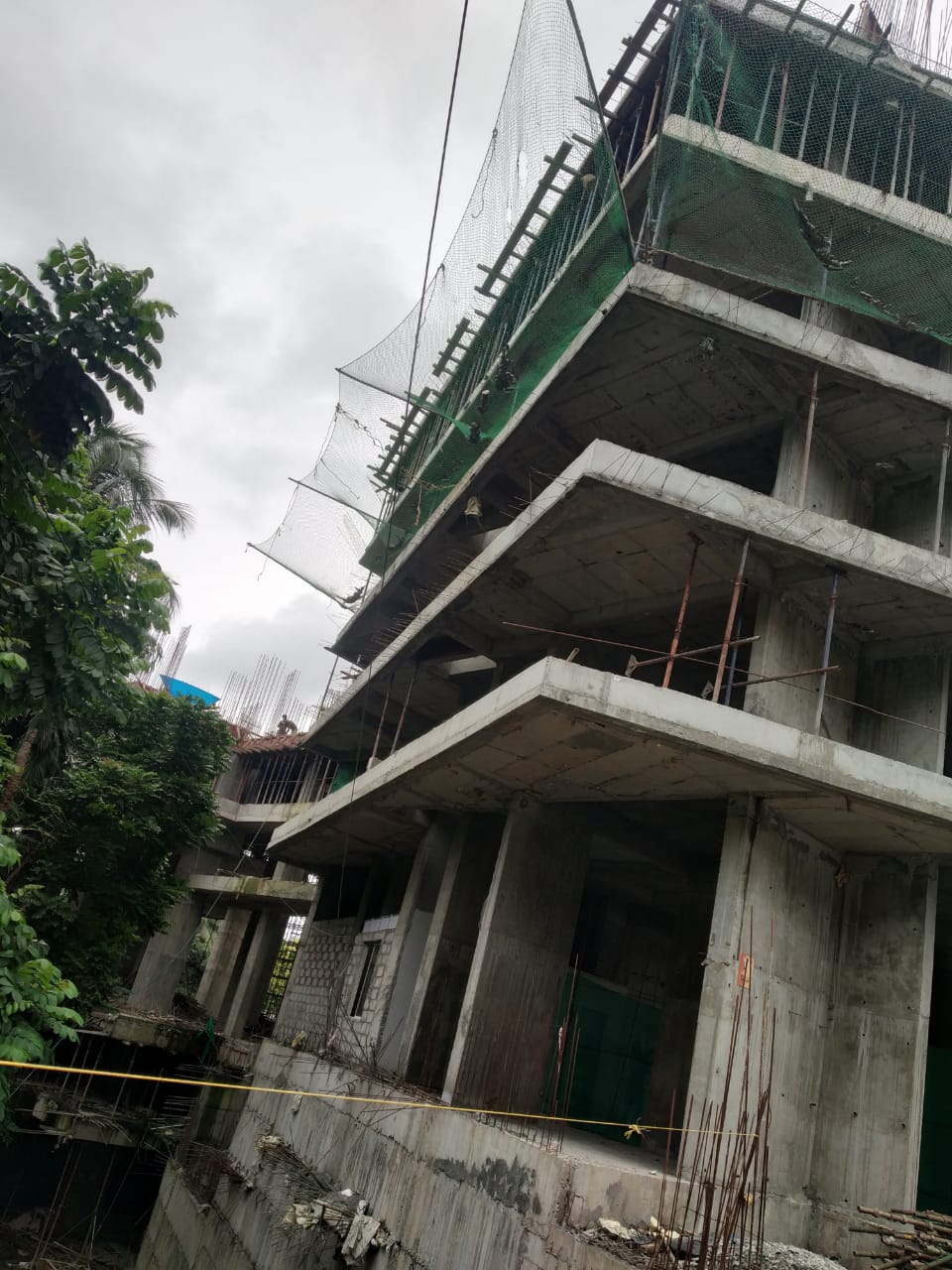

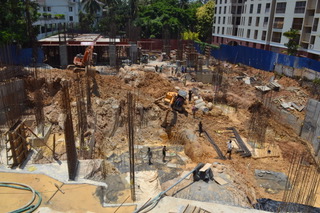

            • Piling work – 100% completed
            • Earth work – 90% completed
            • Pile chipping work – 319 nos completed (out of 323)
            • Pile cap work -92% completed
            • RCC for slab – BF1-6th floor slab -RCC work 100% completed, 7th floor slab -RCC work 90% completed
            • Column work: 6th floor -100% completed, 7th floor -40% completed, RCC for ramp, BF2 :35% completed
            • Ceiling Plastering (2nd floor ):90% completed (3rd floor); 70% completed
            • Block work: Second floor:10% Completed

As per the current work status from our site, we are targeted to complete the following works by the end of February 2020

            • Rcc for slab 7th 100% to be completed.
            • Column work : 6th-100% to be completed, 7th 30% to be completed, Base floor 2 : 35% to be completed
            • Ceiling: Second floor: 100% to be completed, Third floor: 70% to be completed
            • Block work (2ndfloor): 50% to be Completed

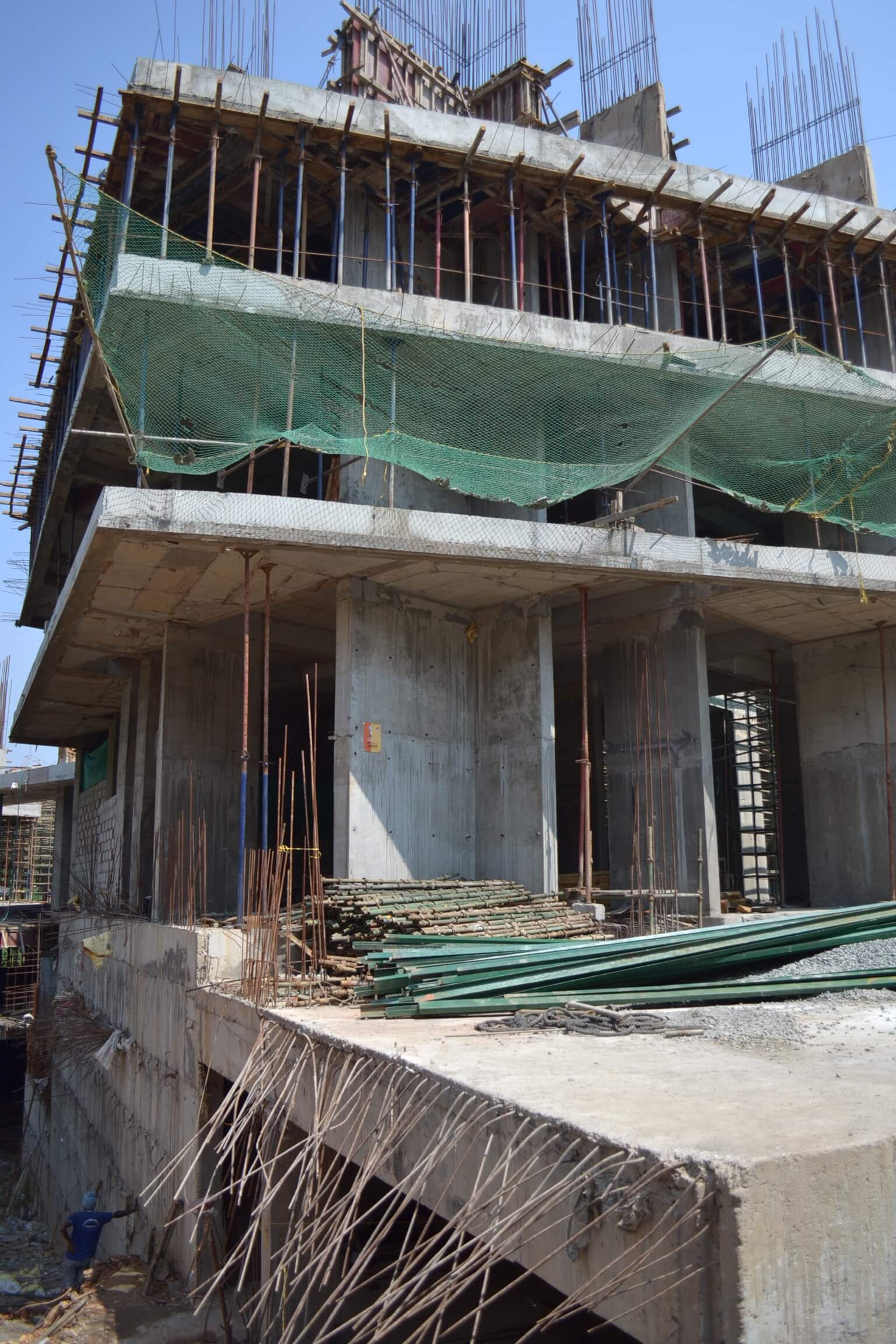

Work status as on 08-02-2020, we have completed the following.

            • Piling work – 100% completed
            • Earth work – 90% completed
            • Pile chipping work – 319 nos completed (out of 323)
            • Pile cap work -66nos completed (out of 72)
            • RCC for slab – BF2 slab – 100%completed.
            • BF1-6th floor slab -RCC work 100% completed
            • Column work: 6th -45% completed.
            • RCC for ramb, BF2 :15% Completed
            • Ceiling Plastering (2nd floor ): 90% completed, (3rd floor): 20% completed
            • Block work (2nd floor): 10% Completed

As per the current work status from our site, we are targeted to complete the following works by the end of JANUARY 2020

            • 6th floor slab -100% to be completed.
            • Column work : 5 th -6 th -100%,6-7 th -25% to be completed
            • Block work (2 ndfloor):25% to be Completed

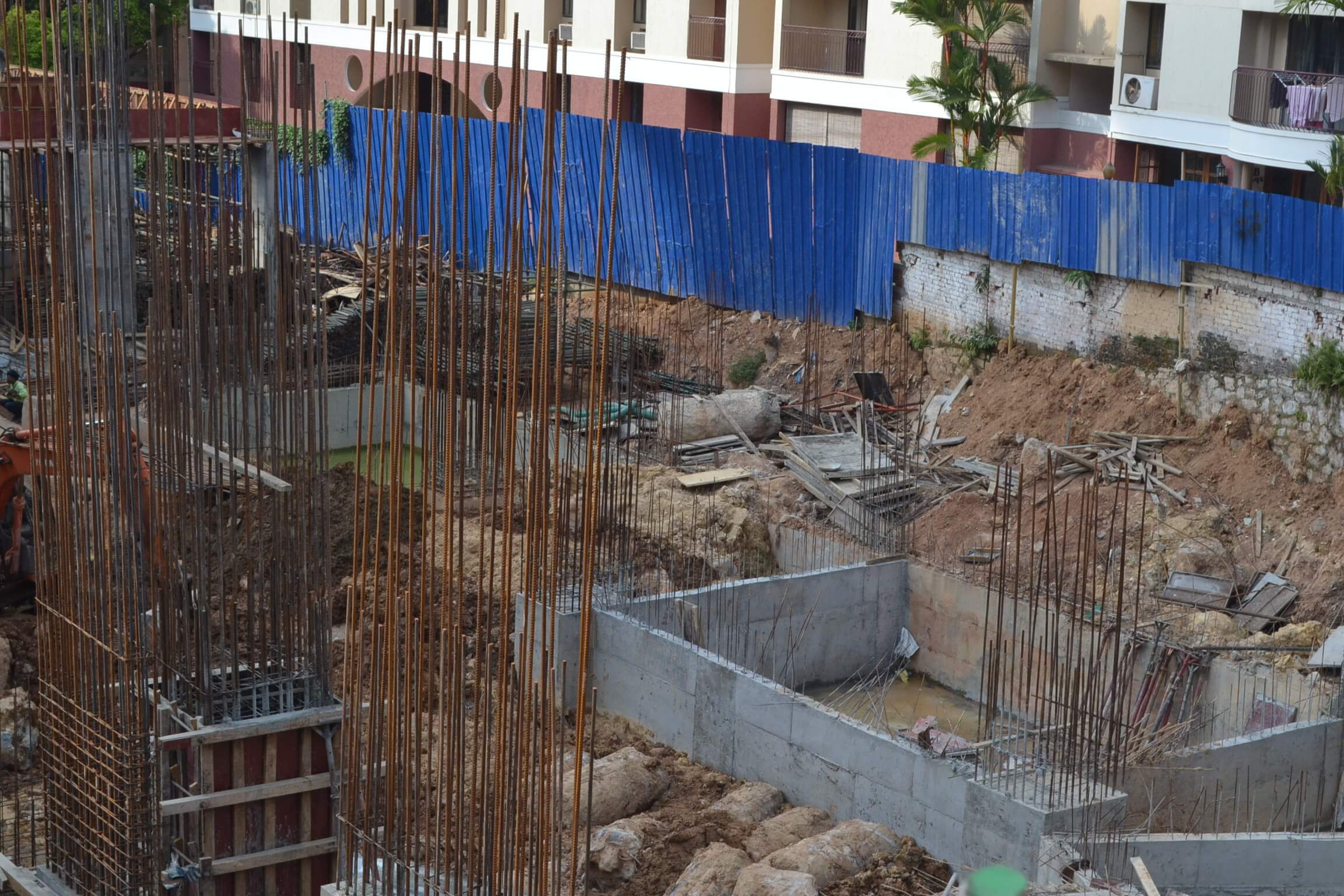

Work status as on 10-01-2020, we have completed the following.

            • Piling work – 100% completed
            • Earth work – 90% completed
            • Pile chipping work – 319 nos completed (out of 323)
            • Pile cap work -66nos completed (out of 72)
            • RCC for slab – BF2 slab – 100%completed.
            • BF1-5 th floor slab -RCC work 100% completed
            • 6 th floor -60% completd.
            • Column work : 5-6 th -75% completed .
            • Ceiling Plastering (2nd floor ): 50% completed
            • Block work (2nd floor): 10% Completed

As per the current work status from our site we are targeted to complete the following works by end of September 2019

            • 5 th floor slab -45% to be completed,6 th floor slab -30% to be completed .
            • Third floor Column work-80% completed, 4 th floor column work -45% completed,5 th floor -25% to be completed.

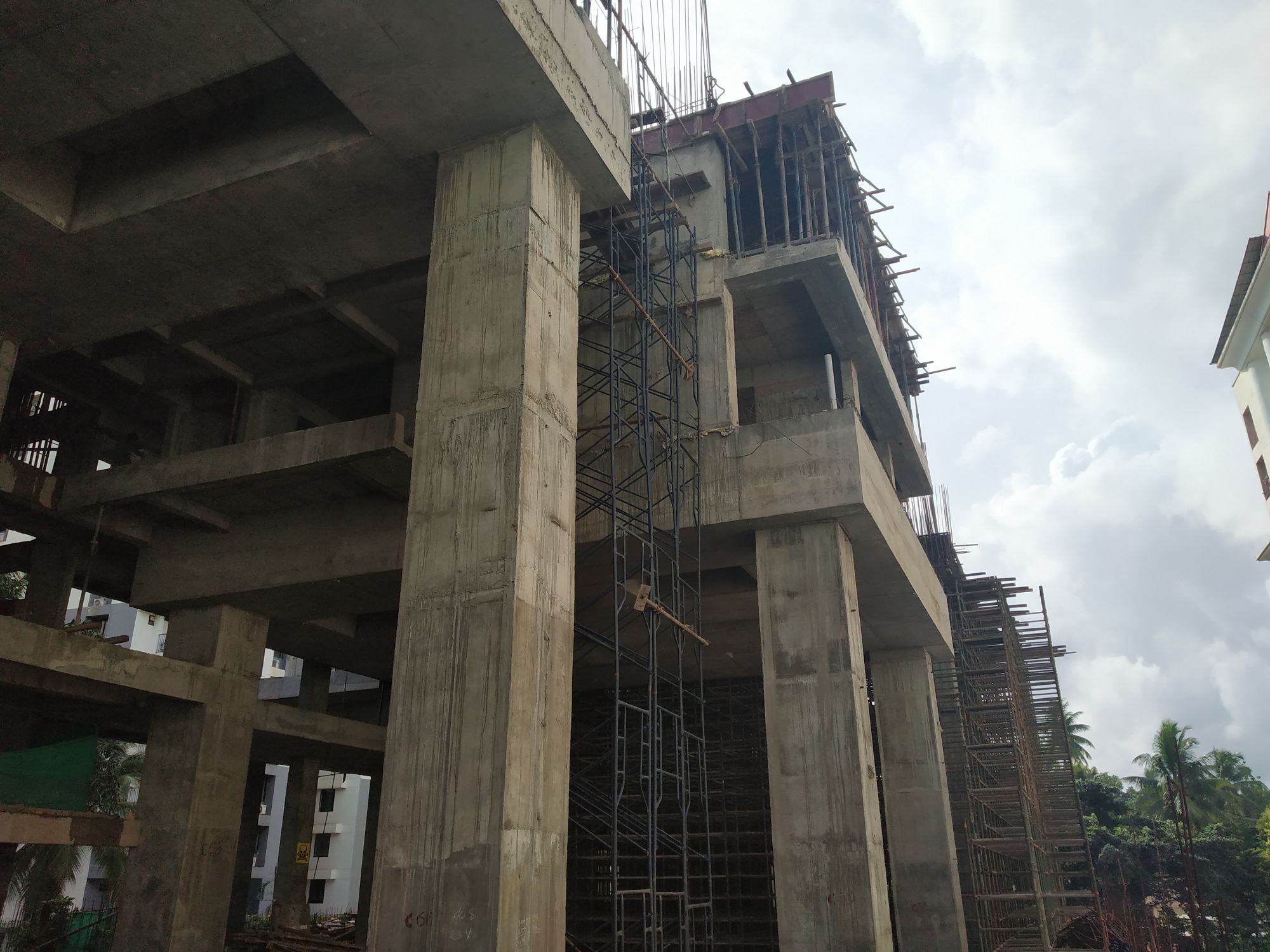

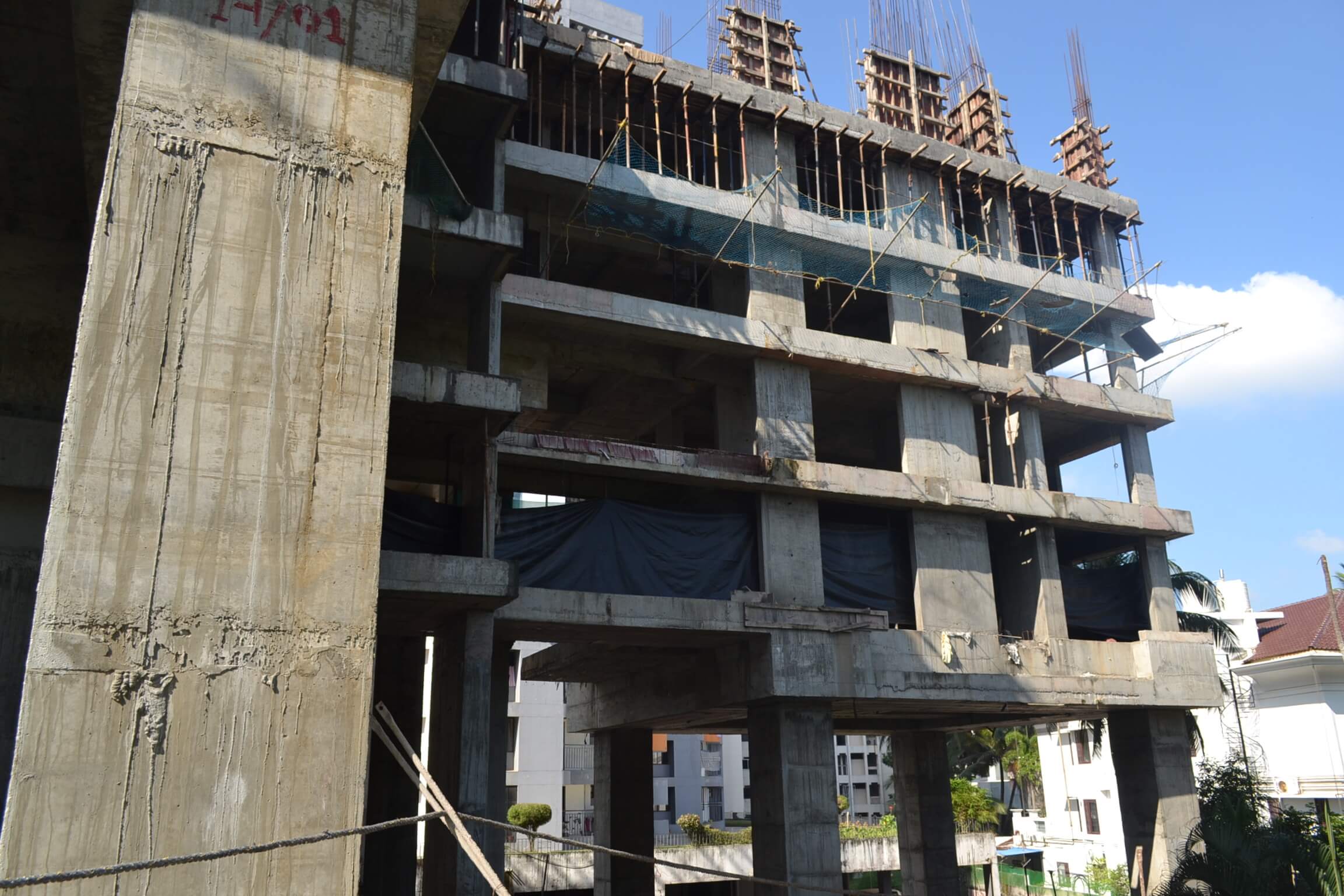

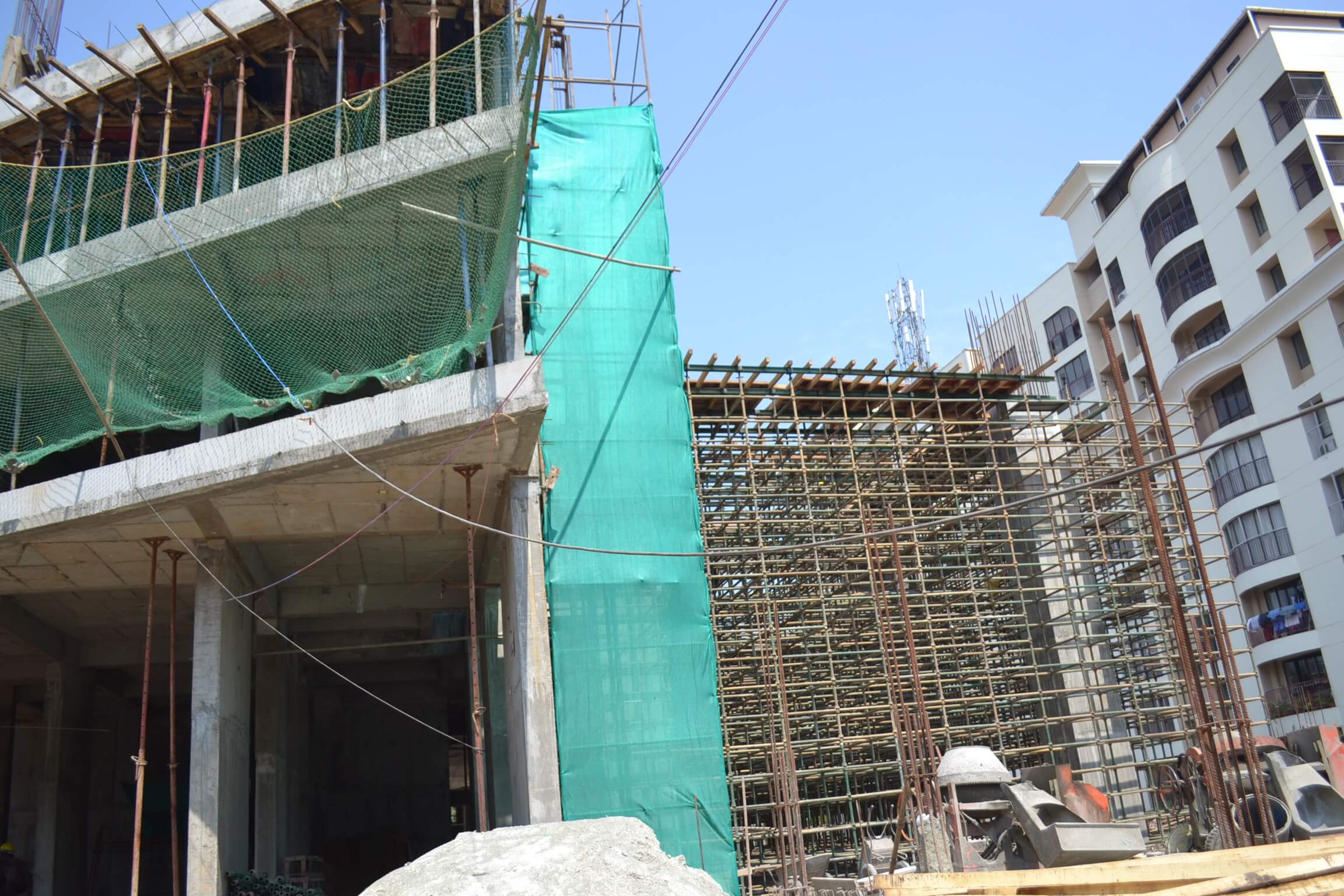

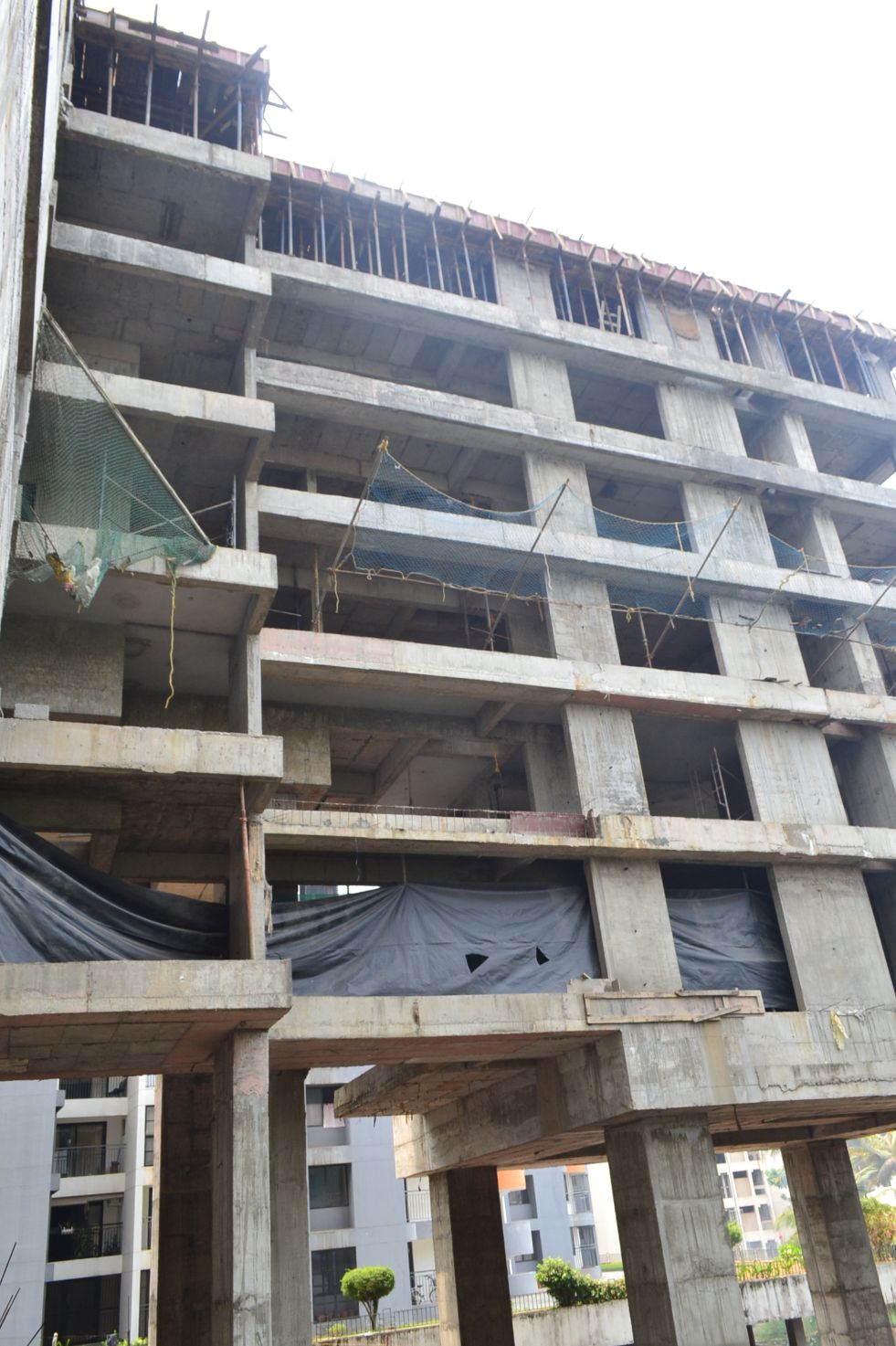

Work status as on 05.09.2019, we have completed the following

            • Piling work – 100% completed
            • Earth work – 90% completed
            • Pile chipping work – 319 nos completed (out of 323)
            • Pile cap work -66nos completed (out of 72)
            • RCC for slab – BF2 slab – 100%completed.
            • BF1 slab -RCC work 100% completed
            • Ground floor slabs -RCC Work100%completed.
            • First floor slab -100%completed
            • Second floor slab -100% completed
            • Third floor slab -100% completed 4th floor -45% completed 5 th -30% completed
            • BF2- 1st floor Column Rcc work -100% completed,Second floor Column work – 100% completed
            • Third floor Column work-51% completed, 4 th floor column work -37% completed,5 th floor -25% completed.

As per the current work status from our site we are targeted to complete the following works by end of August 2019

            • Third floor slab -100% ,4 th floor slab -60%,5 th floor slab -45% to be completed.
            • Fourth floor Column work-40% to be completed,5 th floor column work -25% to be completed

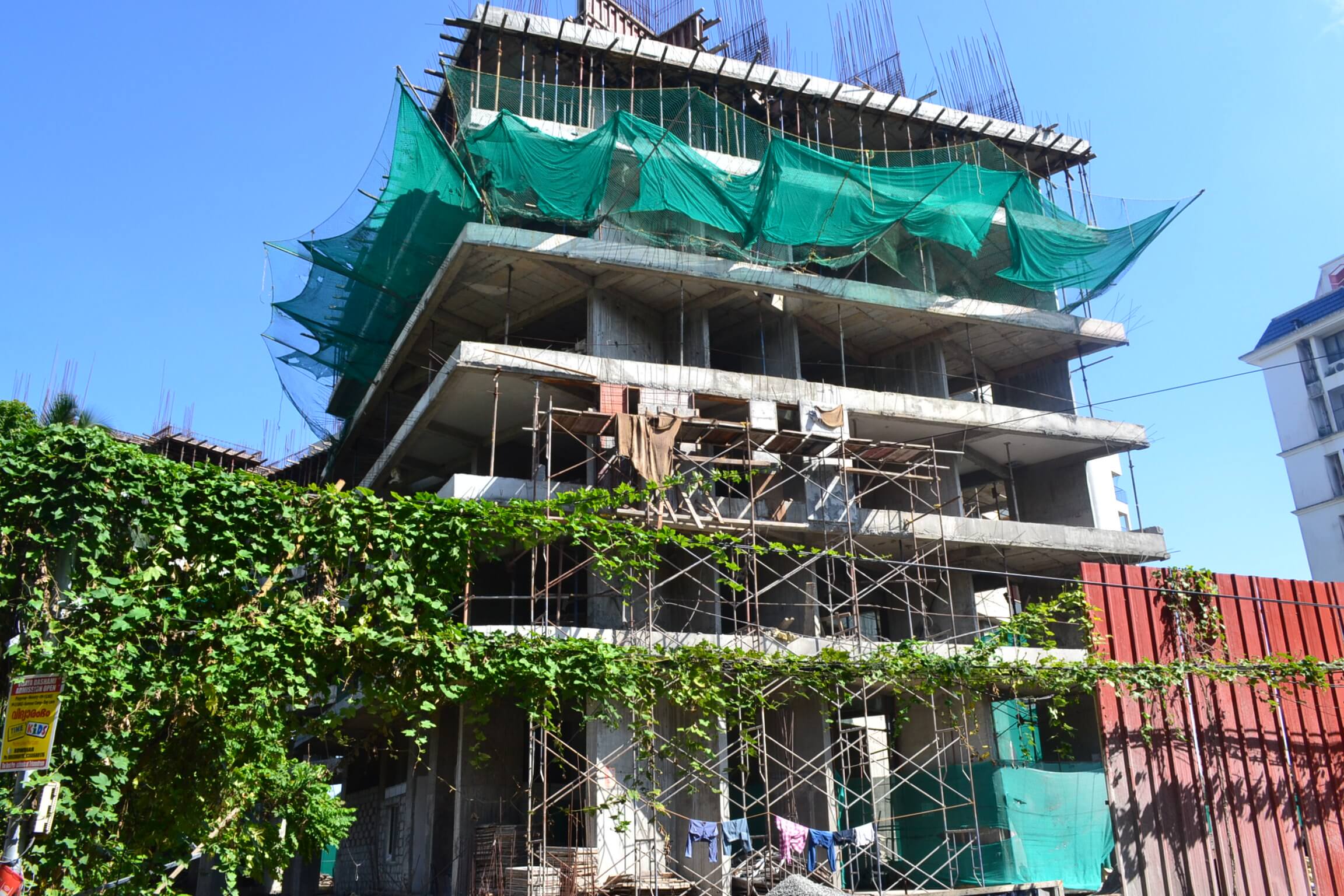

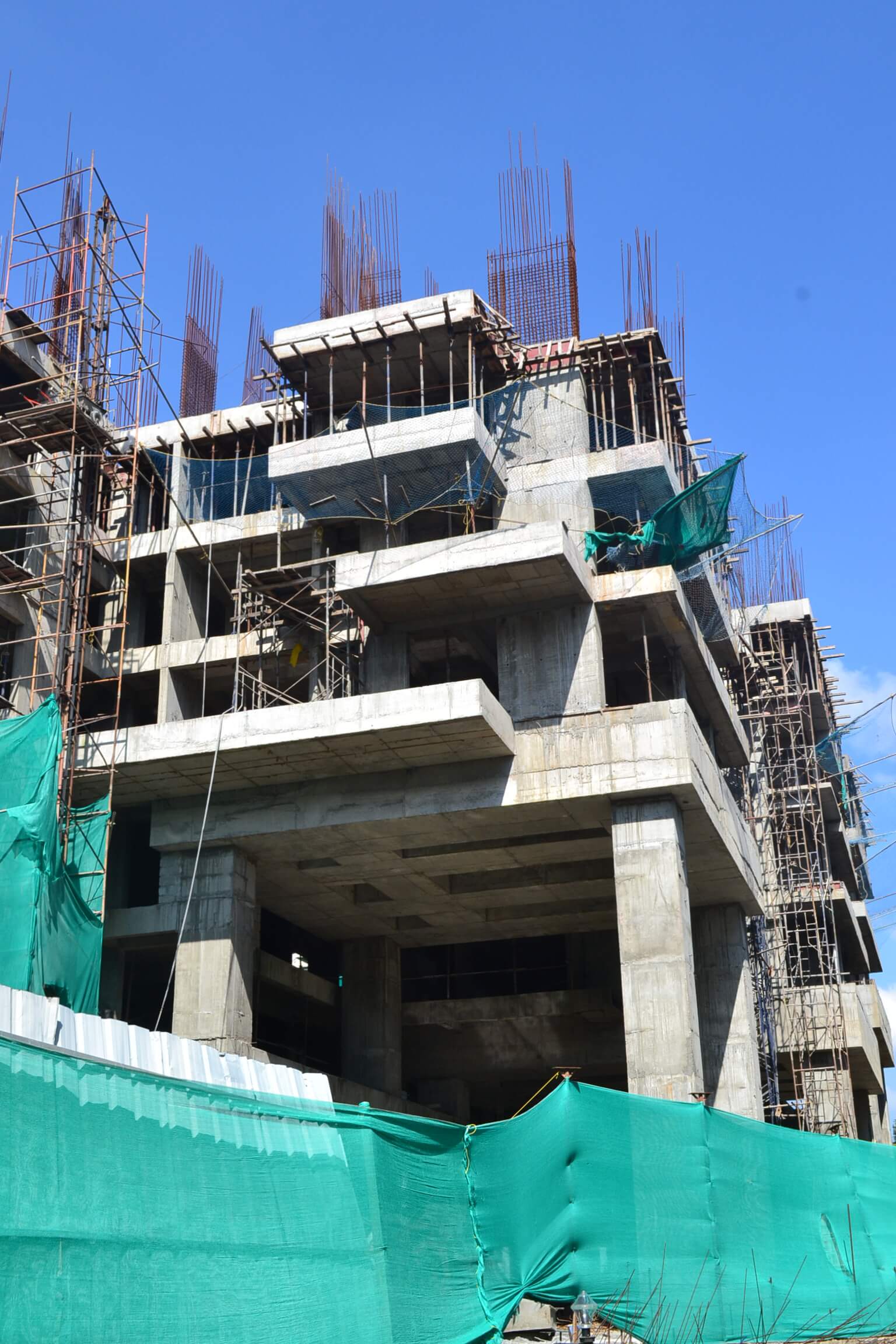

Work status as on 05.09.2019, we have completed the following

            • Piling work – 100% completed
            • Earth work – 90% completed
            • Pile chipping work – 319 nos completed (out of 323)
            • Pile cap work -66nos completed (out of 72)
            • RCC for slab – BF2 slab – 100%completed.
            • BF1 slab -RCC work 100% completed
            • Ground floor slabs -RCC Work100%completed.
            • First floor slab -100%completed
            • Second floor slab -100% completed
            • Third floor slab -75% completed, 4th floor -45% completed, 5th -30% completed
            • BF2- 1st floor Column Rcc work -100% completed,Second floor Column work – 100% completed
            • Third floor Column work-42% completed, 4 th floor column work -36% completed.

As per the current work status from our site we are targeted to complete the following works by end of July 2019

            • Third floor slab -100% ,4 th floor slab -45%,5 th floor slab -30% to be completed.
            • Second floor Column work -100% to be completed
            • Fourth floor Column work-40% to be completed

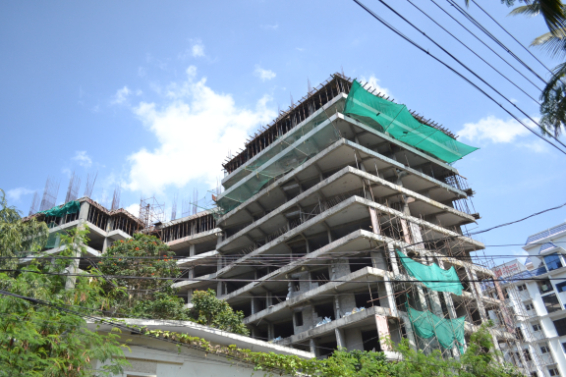

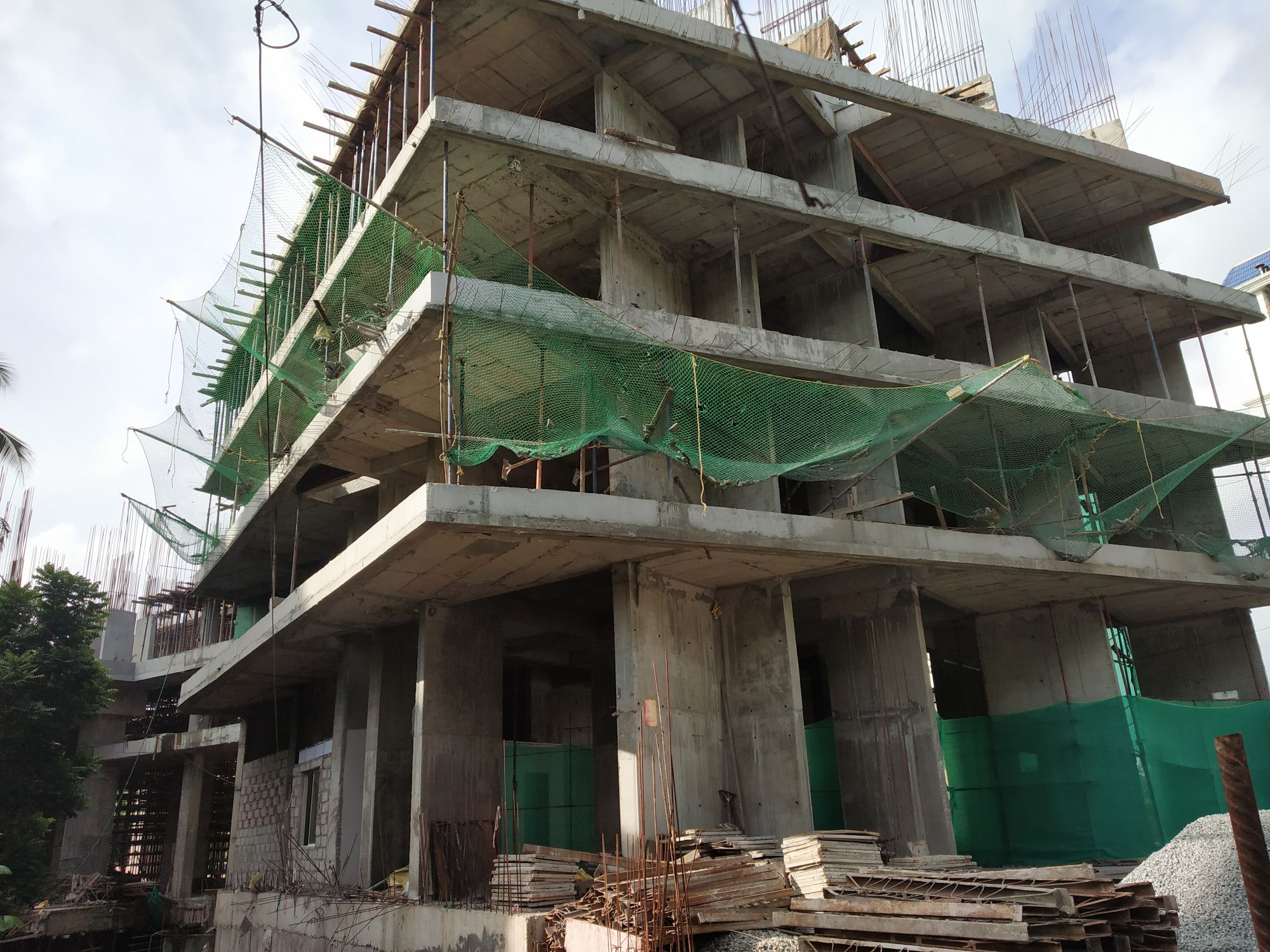

Work status as on 06.07.2019, we have completed the following

            • Piling work – 100% completed
            • Earth work – 90% completed
            • Pile chipping work – 319 nos completed (out of 323)
            • Pile cap work -66nos completed (out of 72)
            • RCC for slab – BF2 slab – 100%completed.
            • BF1 slab -RCC work 100% completed
            • Ground floor slabs -RCC Work100%completed.
            • First floor slab -100%completed
            • Second floor slab -100% completed
            • Third floor slab -60% completed,4th floor -30% completed
            • BF2- 1st floor Column Rcc work -100% completed
            • Second floor Column work – 95% completed
            • Third floor Column work-42% completed, 4 th floor column work -10% to be completed.

As per the current work status from our site we are targeted to complete the following works by end of June 2019

            • Pile chipping work -321 nos to be completed
            • Third floor slab -100% to be completed
            • Second floor Column work -100% to be completed
            • Third floor Column work-40% to be completed
            • Retaining wall -10% to be completed

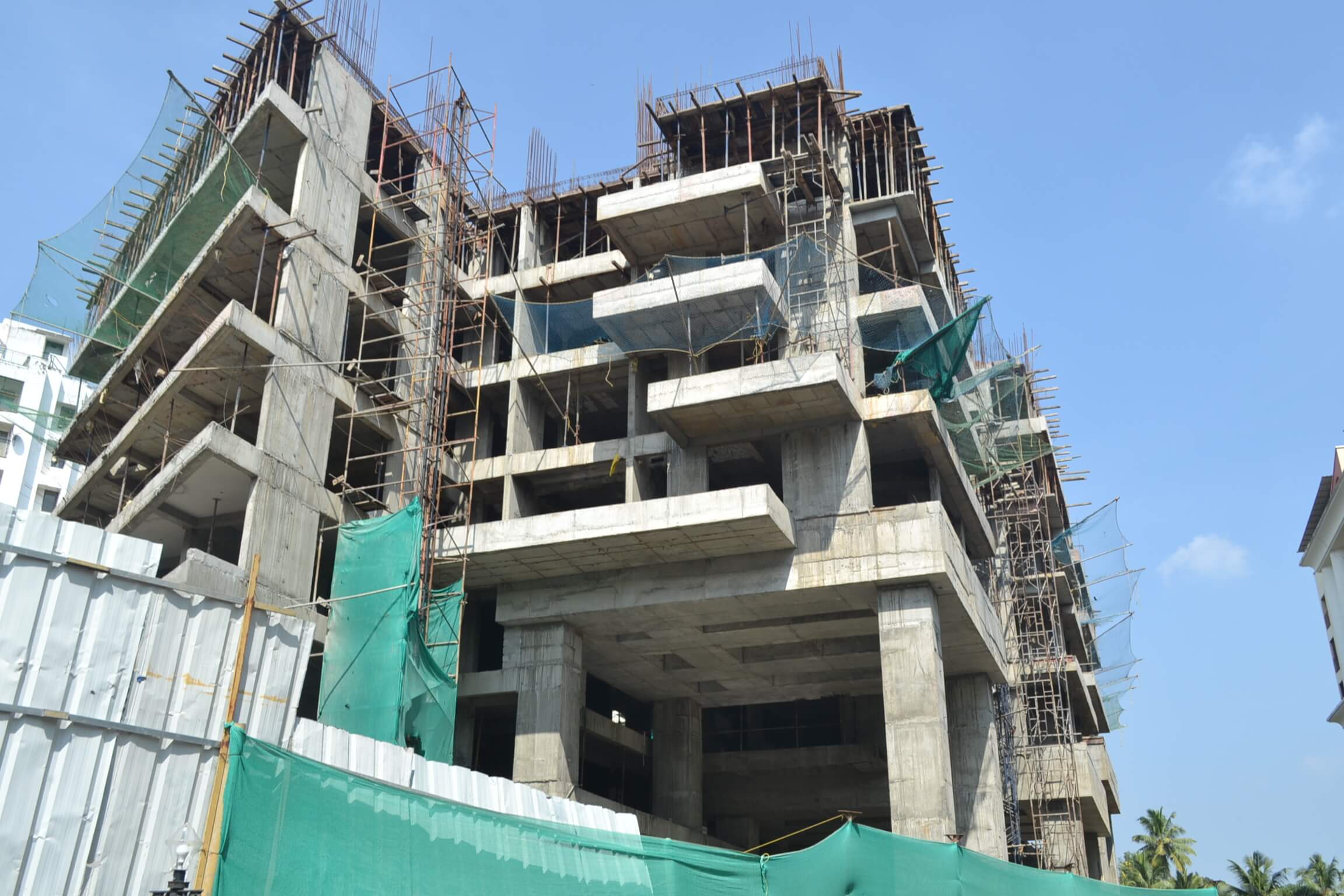

Work status as on 06.06.2019, we have completed the following

            • Piling work – 100% completed
            • Earth work – 90% completed
            • Pile chipping work – 319 nos completed (out of 323)
            • Pile cap work -66nos completed (out of 72)
            • RCC for slab – BF2 slab – 100%completed.
            • BF1 slab -RCC work 100% completed
            • Ground floor slabs -RCC Work100%completed.
            • First floor slab -100%completed
            • Second floor slab -100% completed
            • Third floor slab -45% completed
            • BF2- 1st floor Column Rcc work -100% completed
            • Second floor Column work – 84% completed
            • Third floor Column work-24% completed

As per the current work status from our site we are targeted to complete the following works by end of May 2019

            • Pile chipping work -321 nos to be completed
            • Pile cap work – 68 to be completed (out of 72)
            • Second floor slab -100% tobe completed
            • Third floor slab -45% to be completed
            • Second floor Column work – 70% completed

Work status as on 06.05.2019, we have completed the following

            • Piling work – 100% completed
            • Earth work – 90% completed
            • Pile chipping work – 319 nos completed (out of 323)
            • Pile cap work -66nos completed (out of 72)

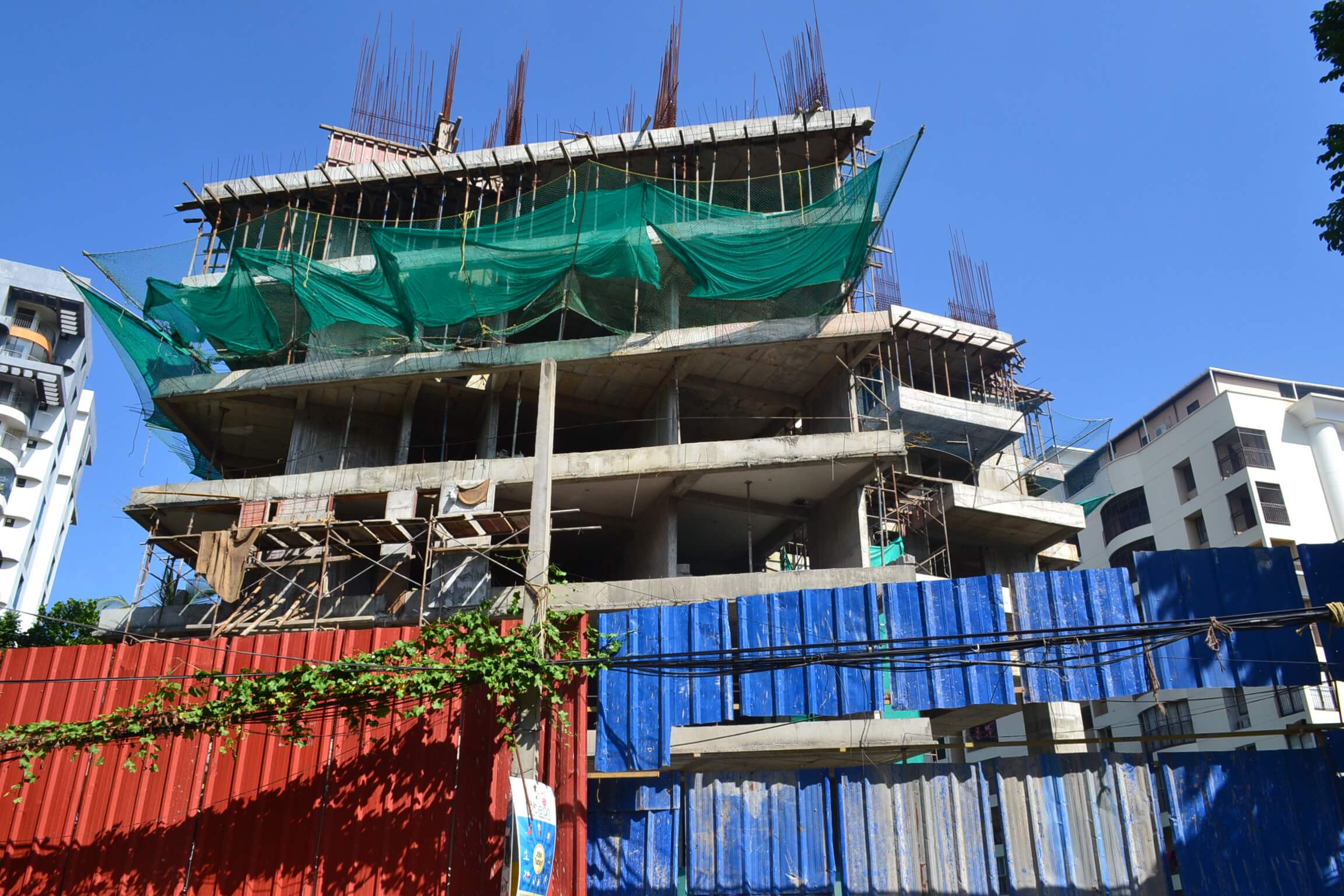

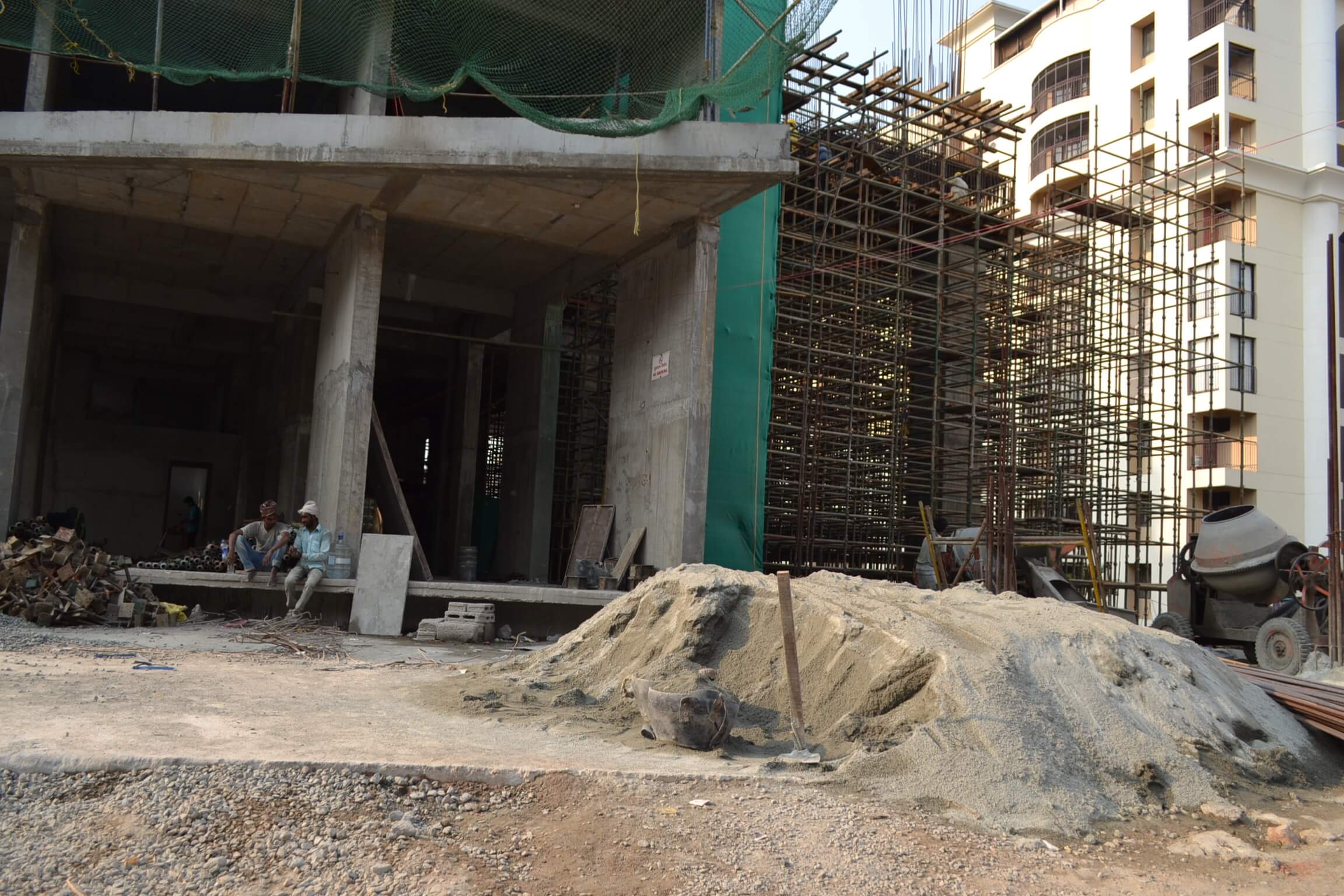

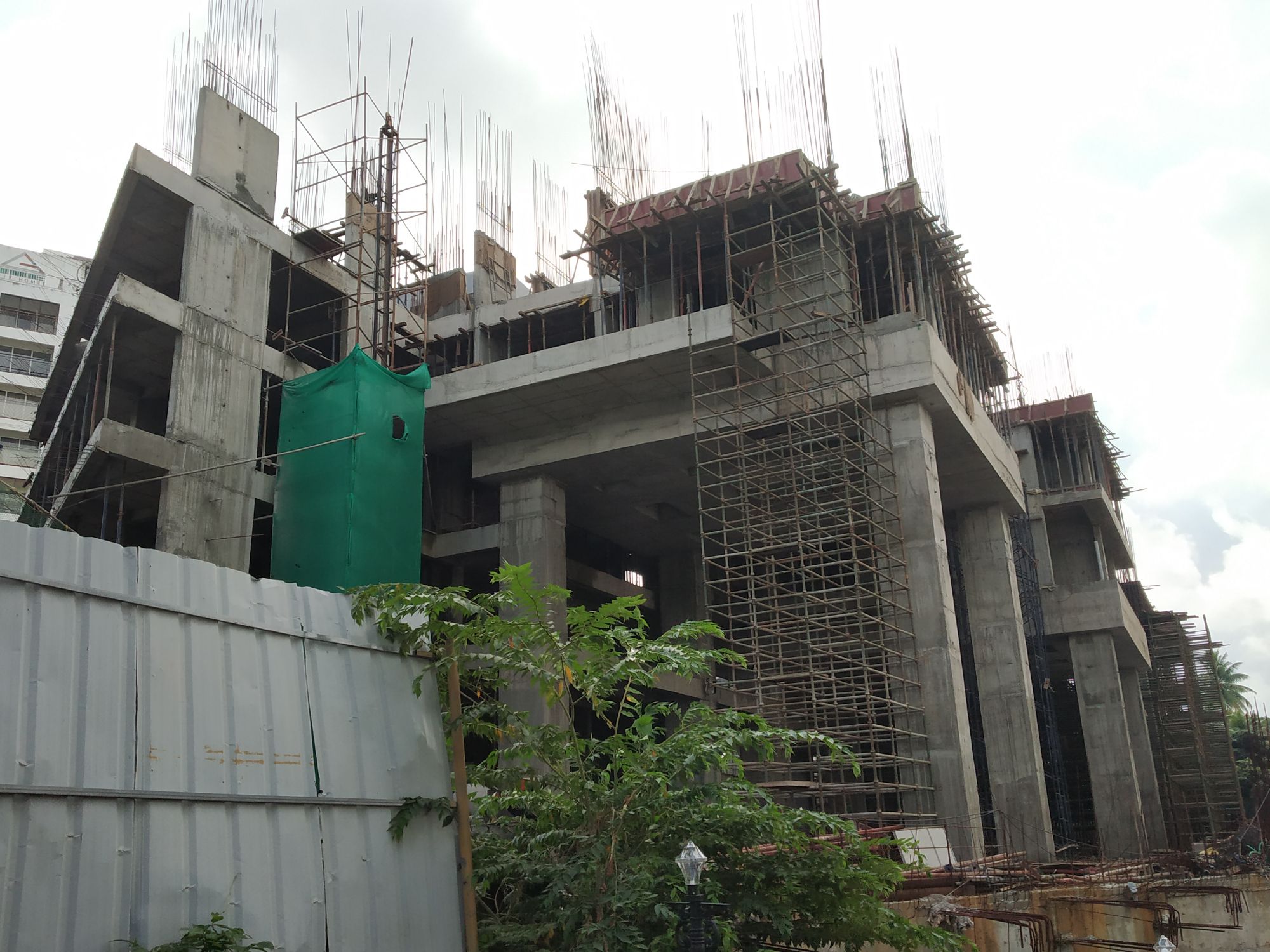

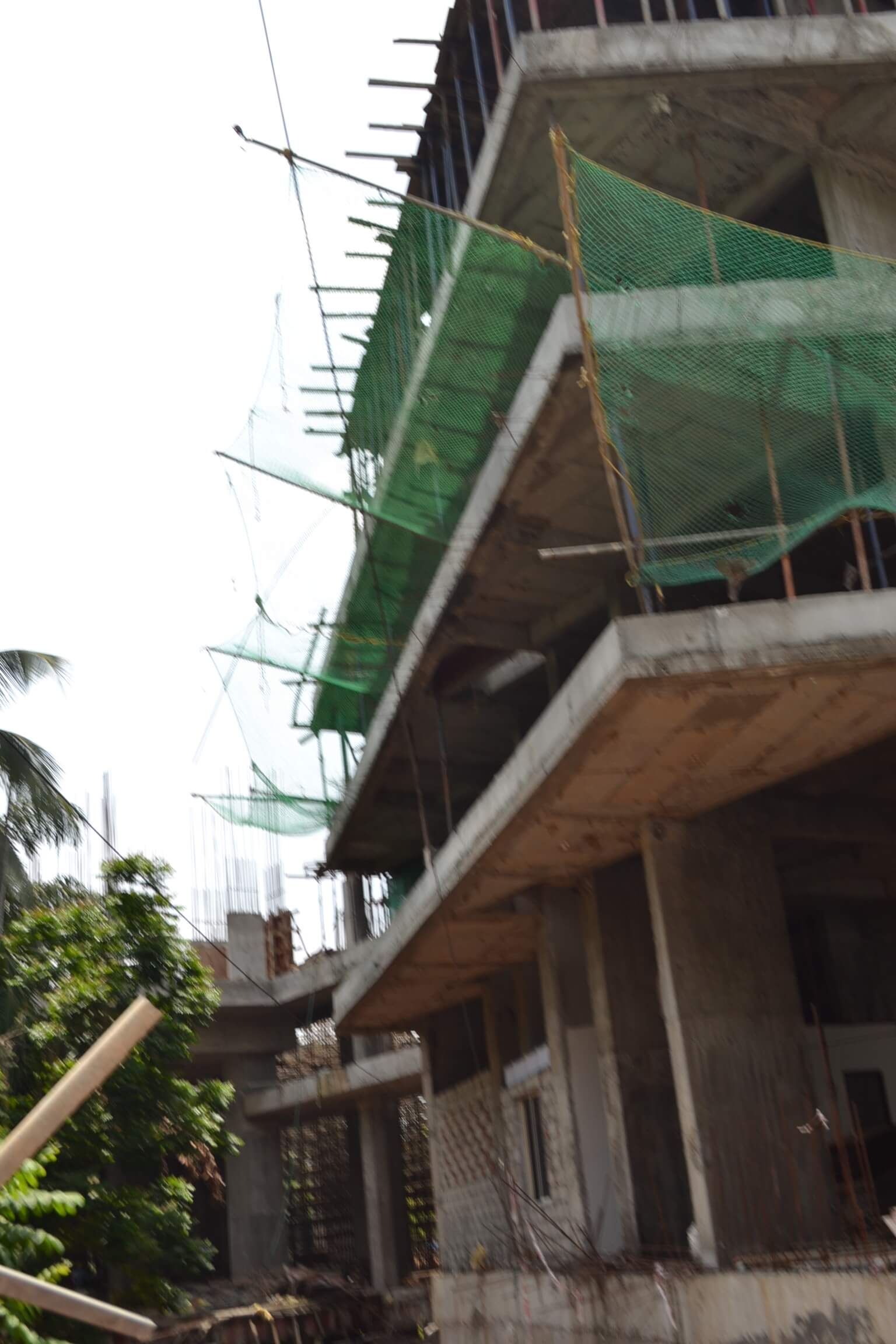

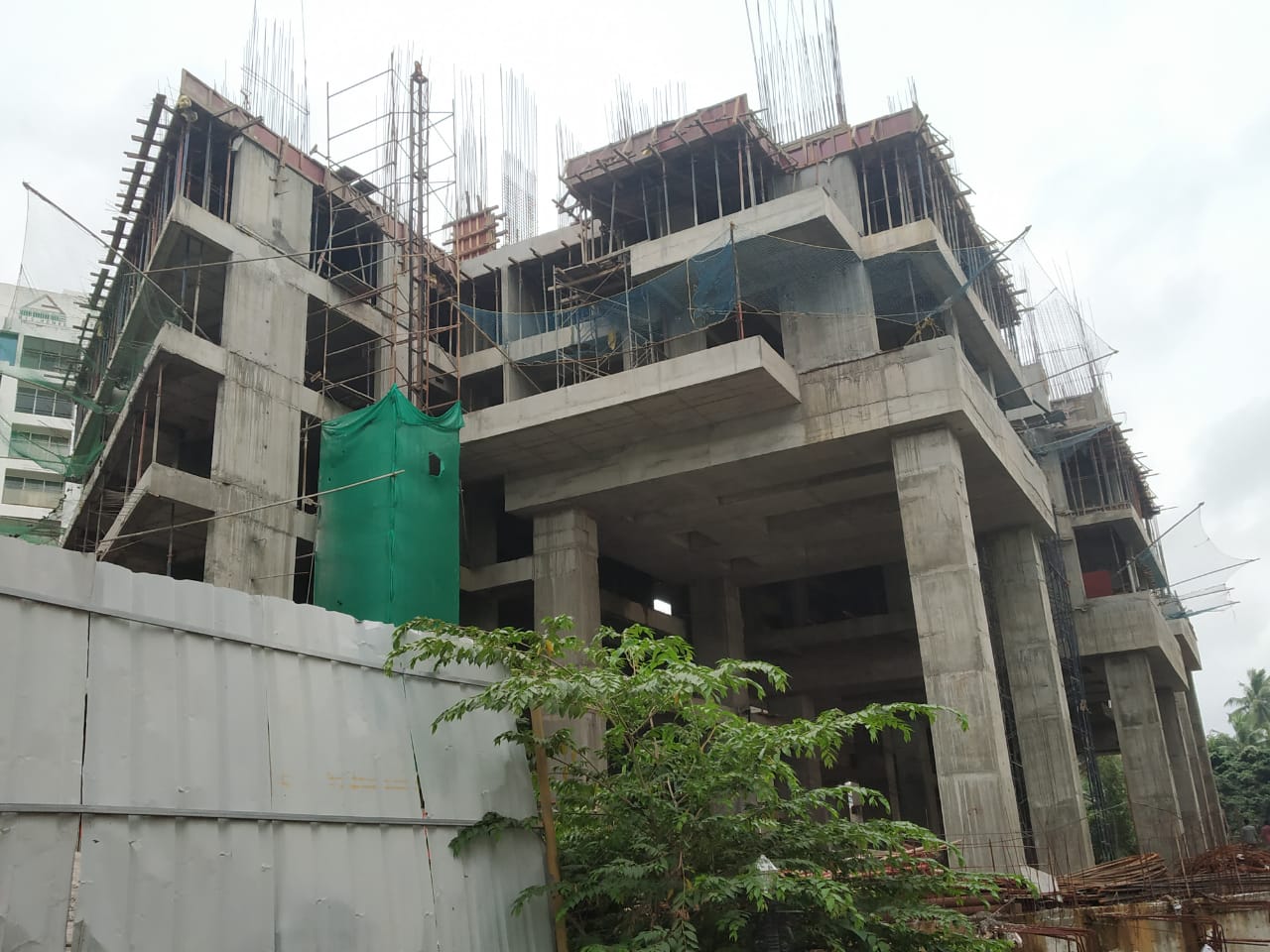

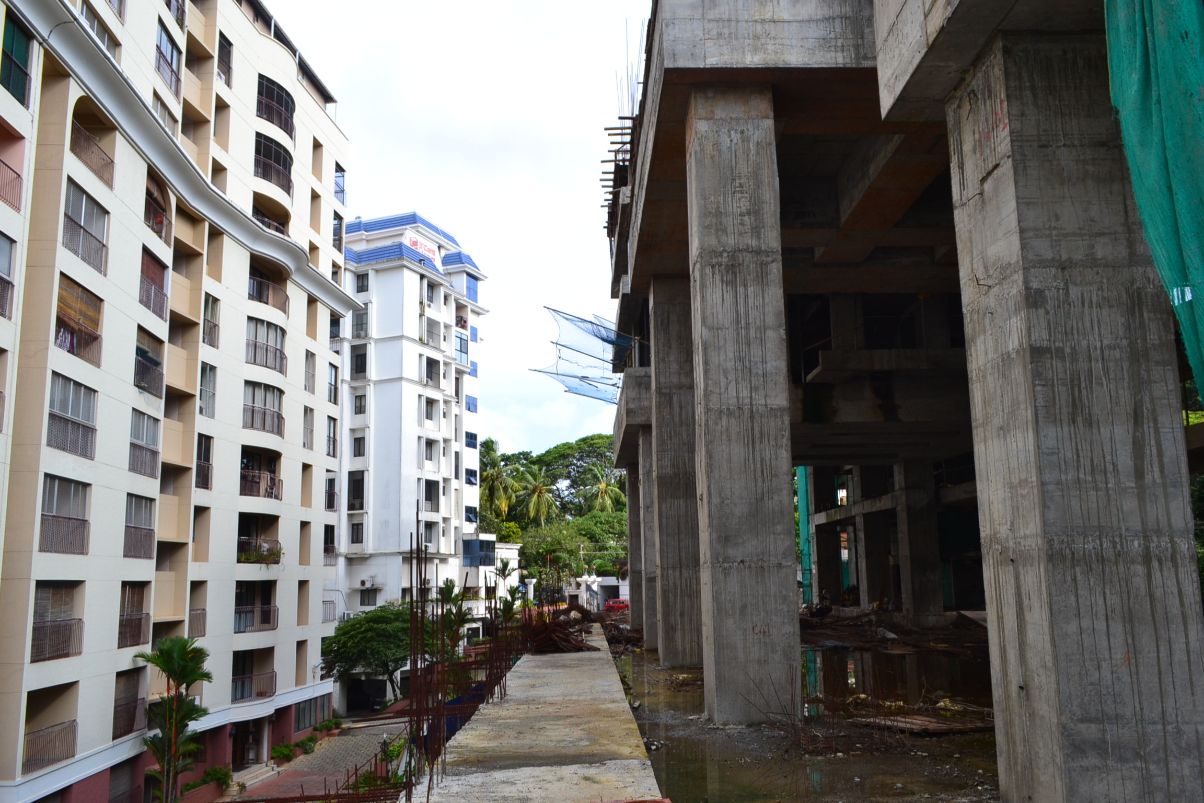

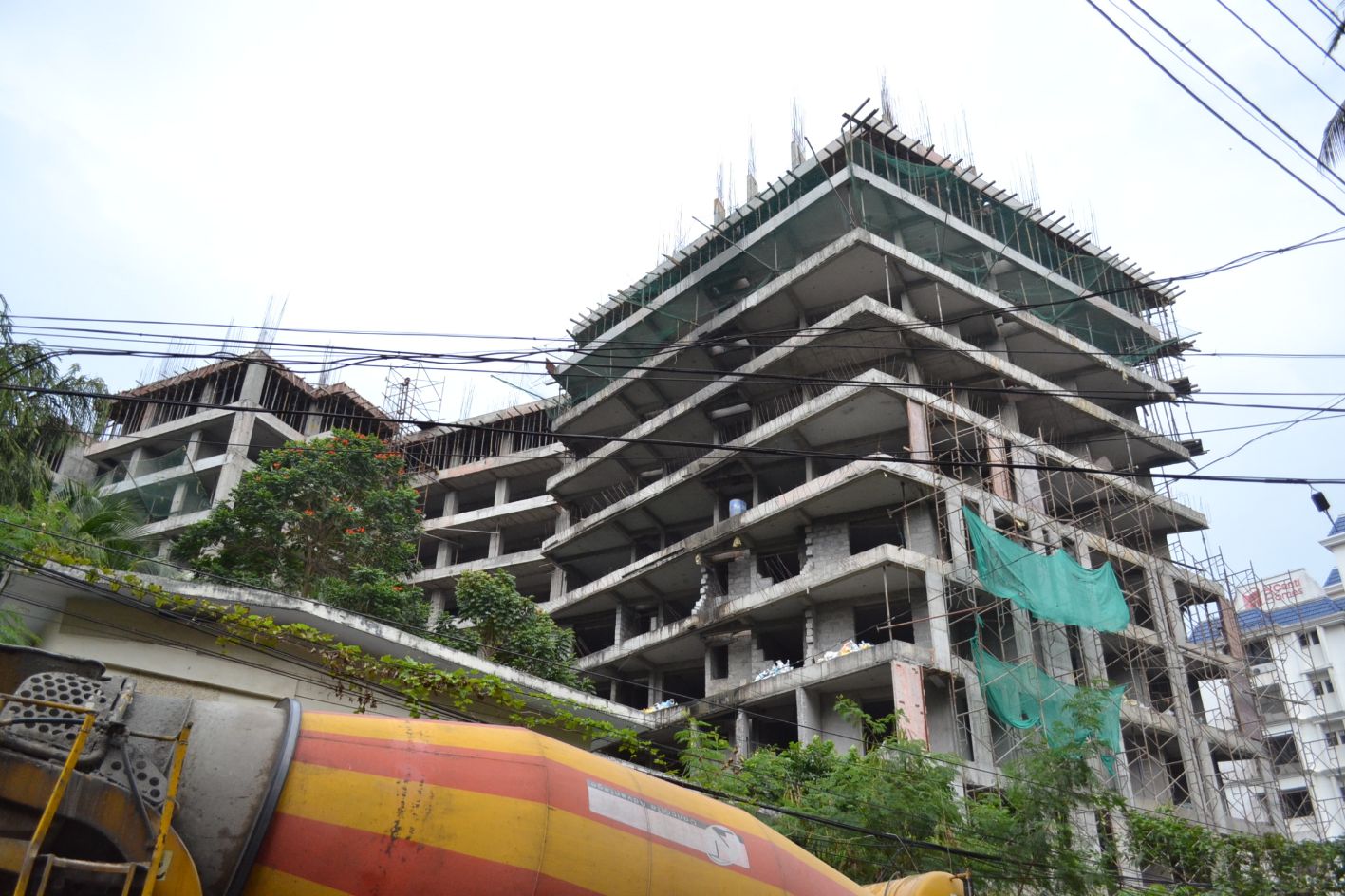

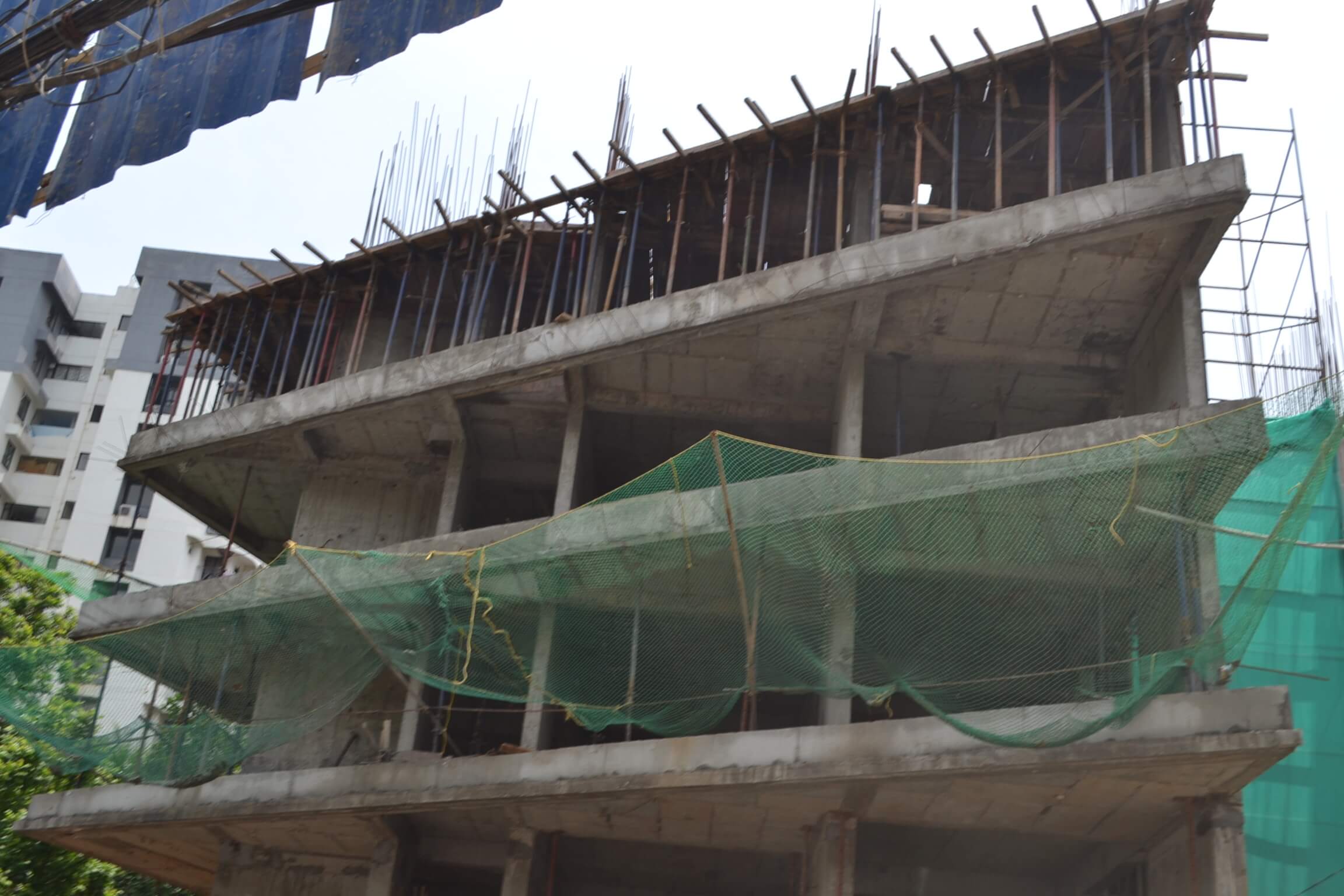

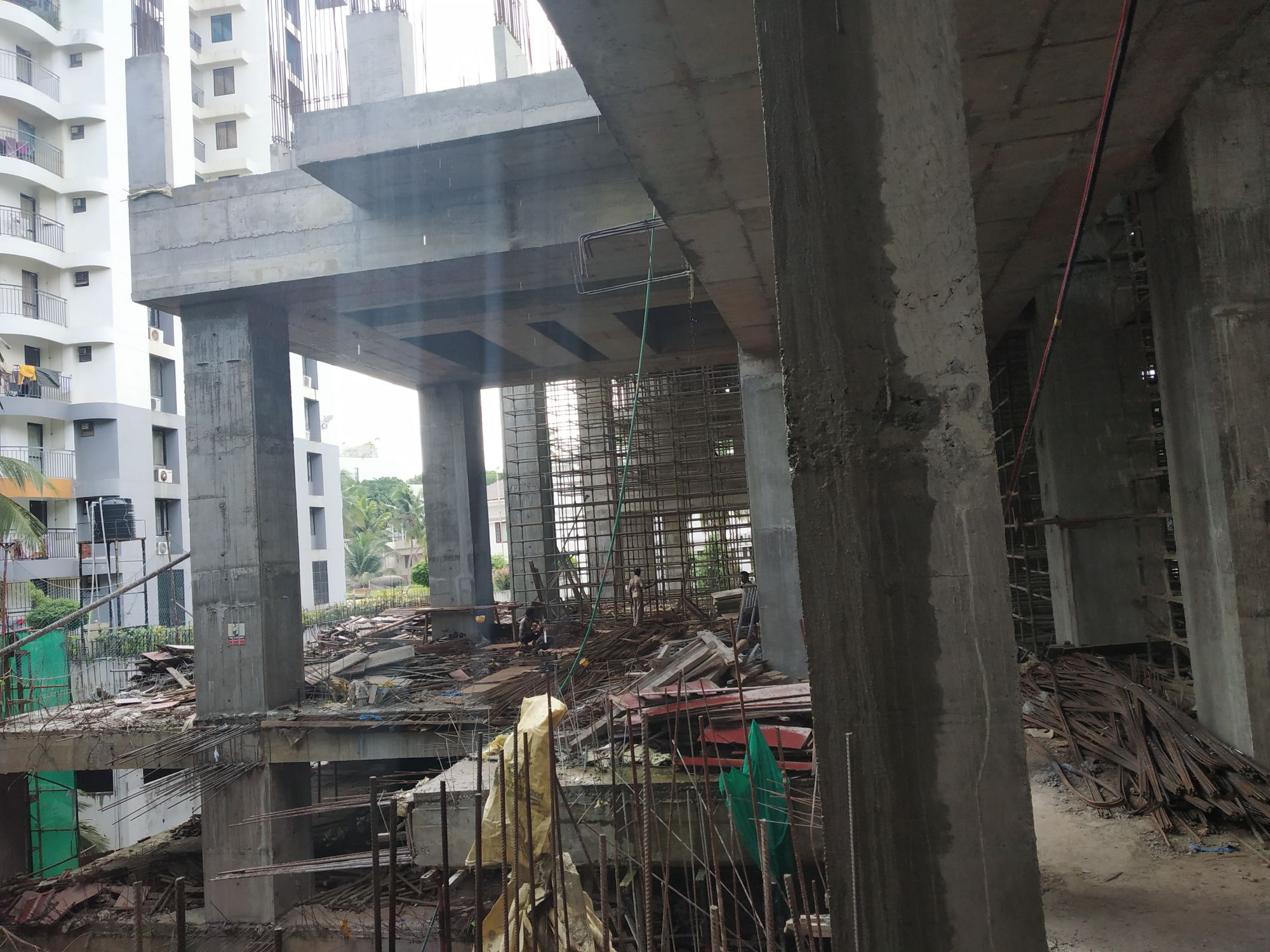

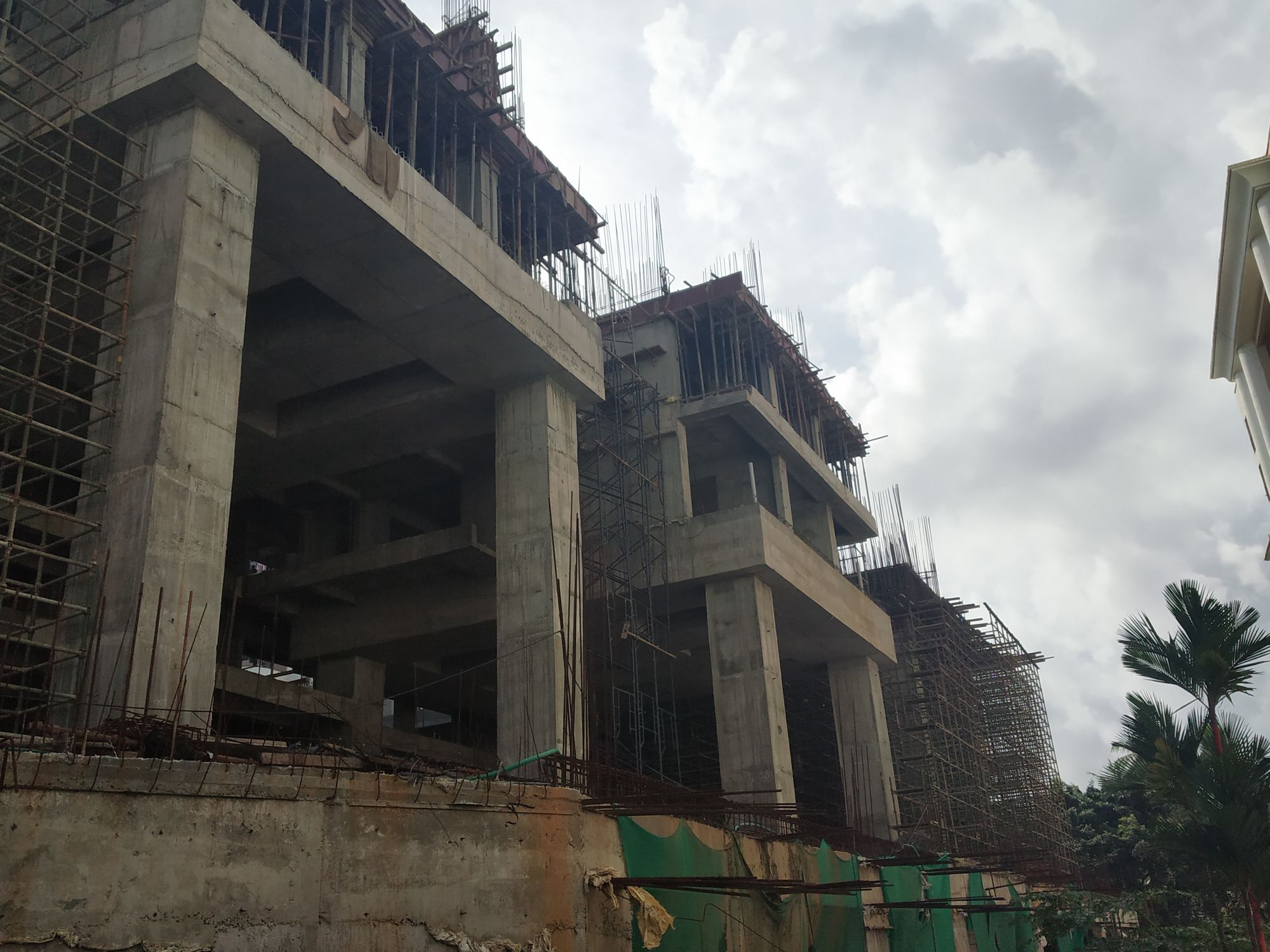

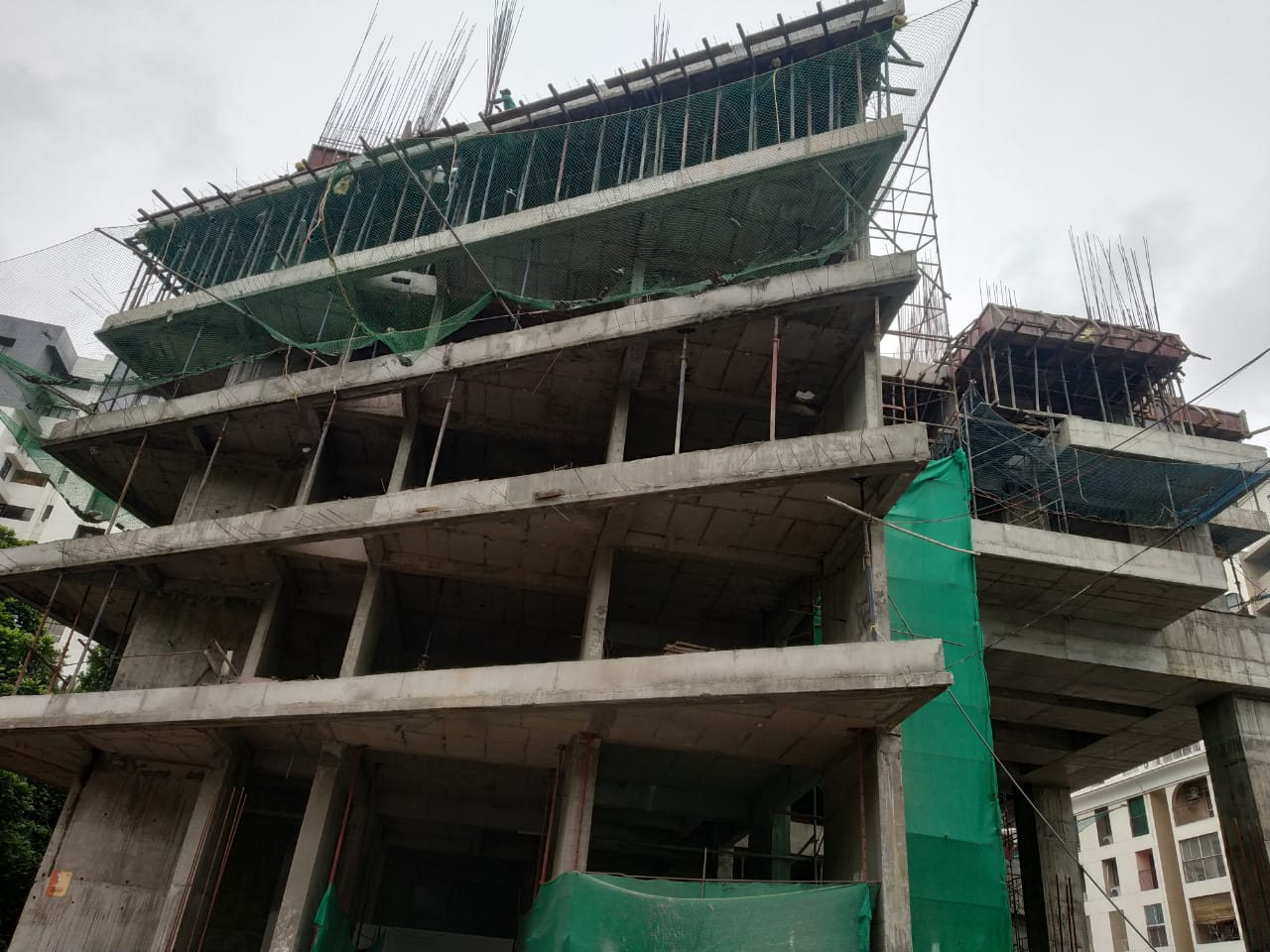

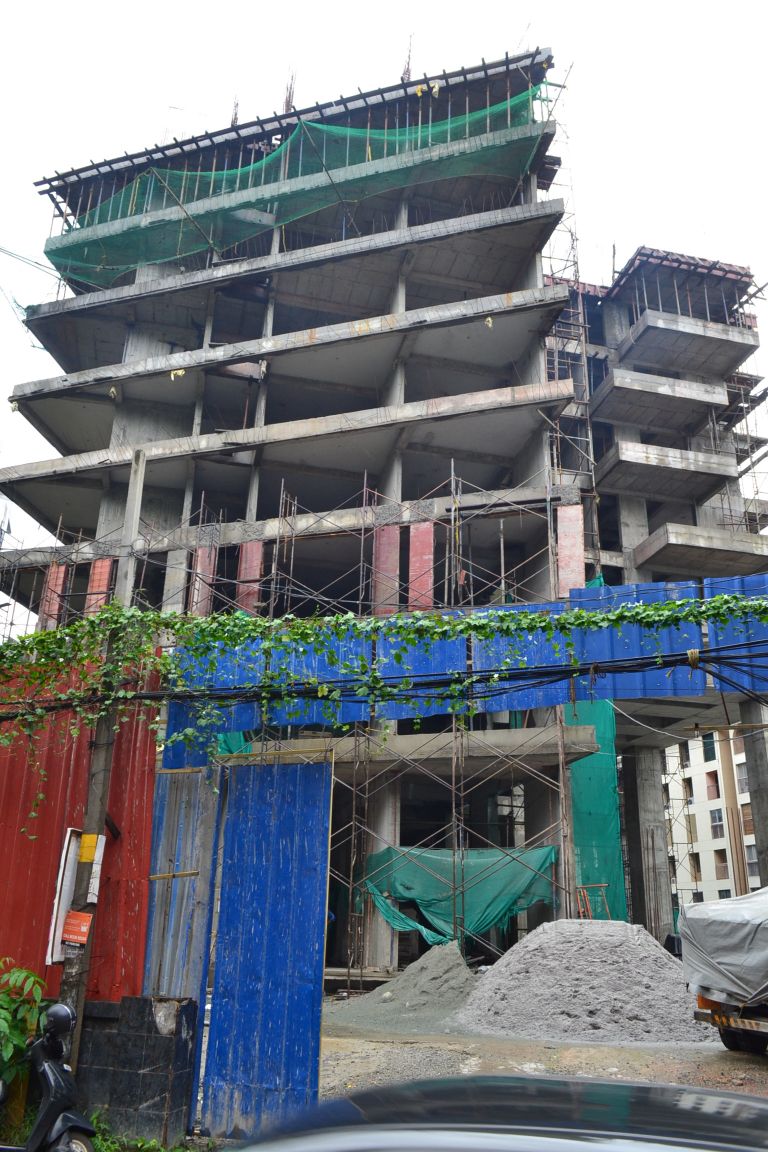

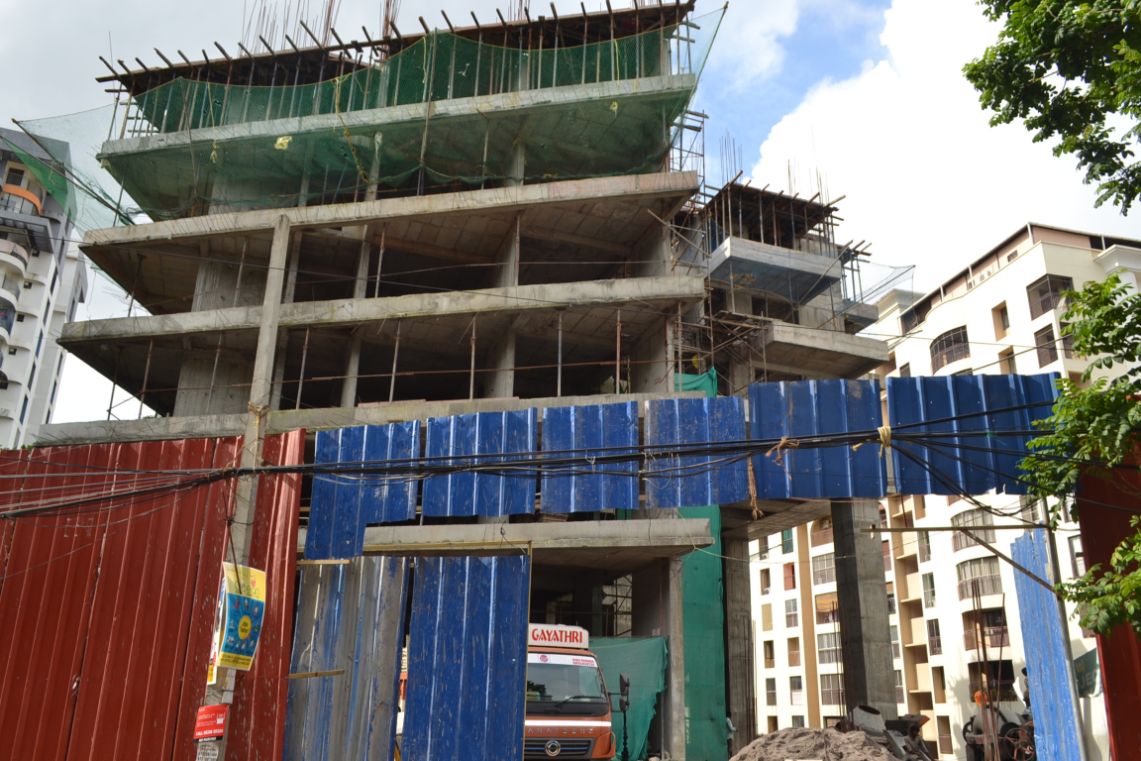

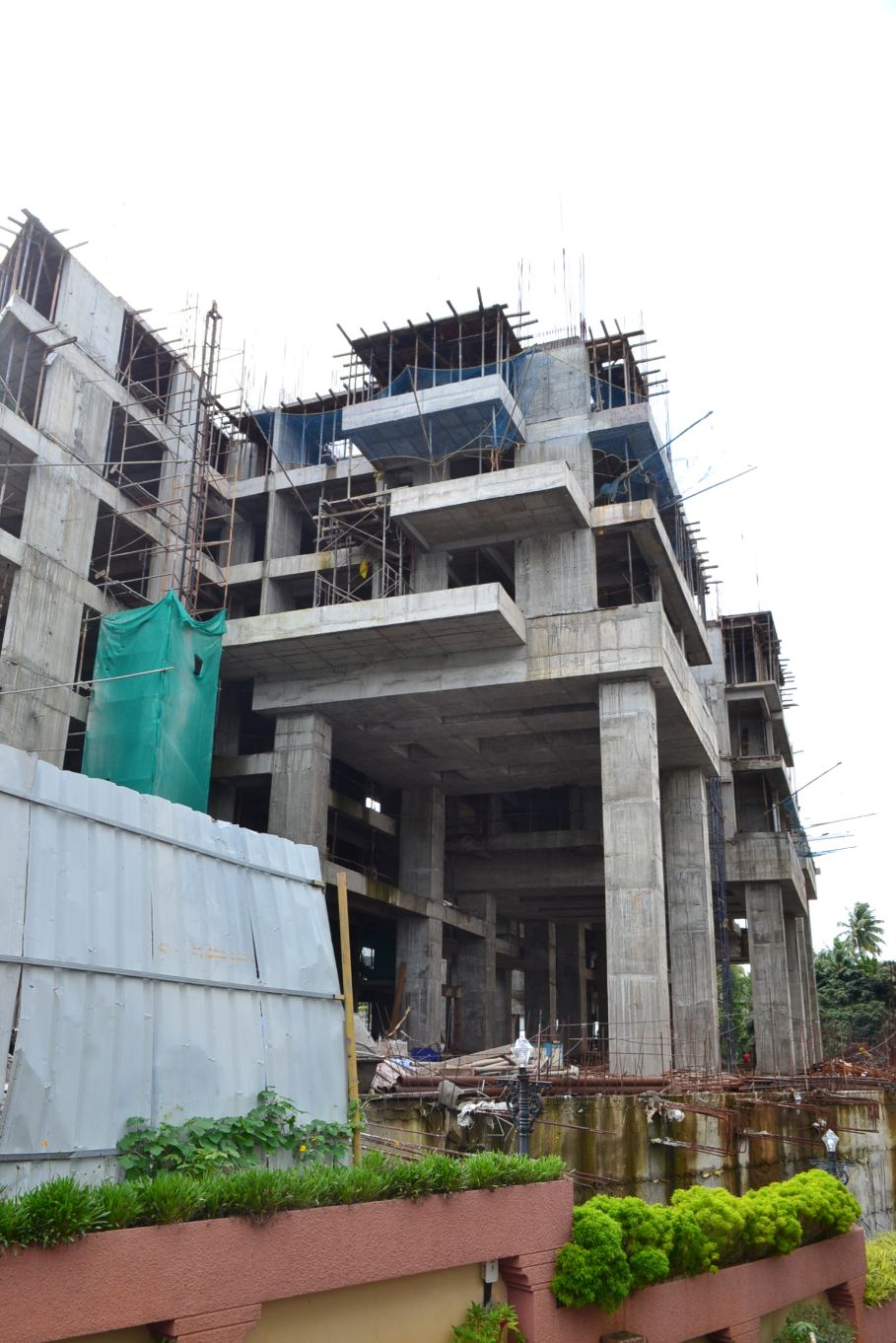

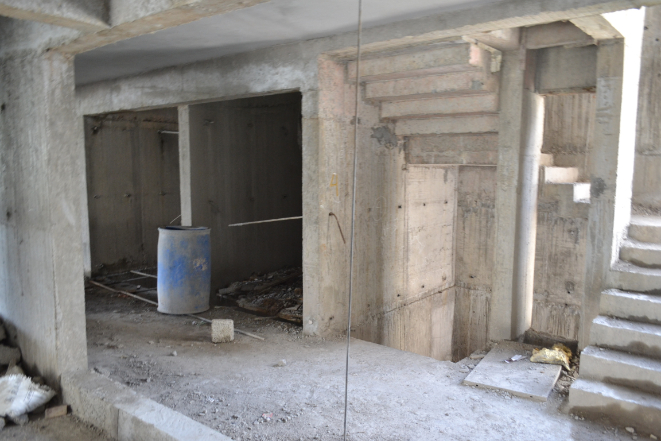

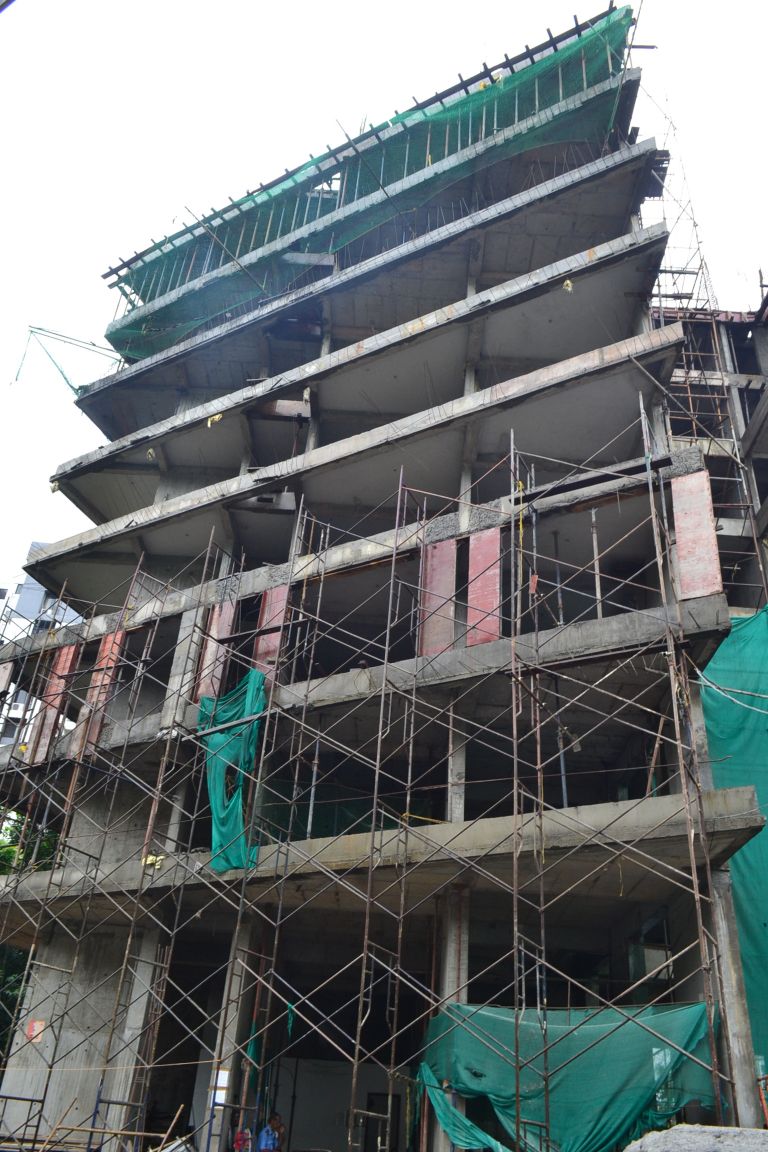

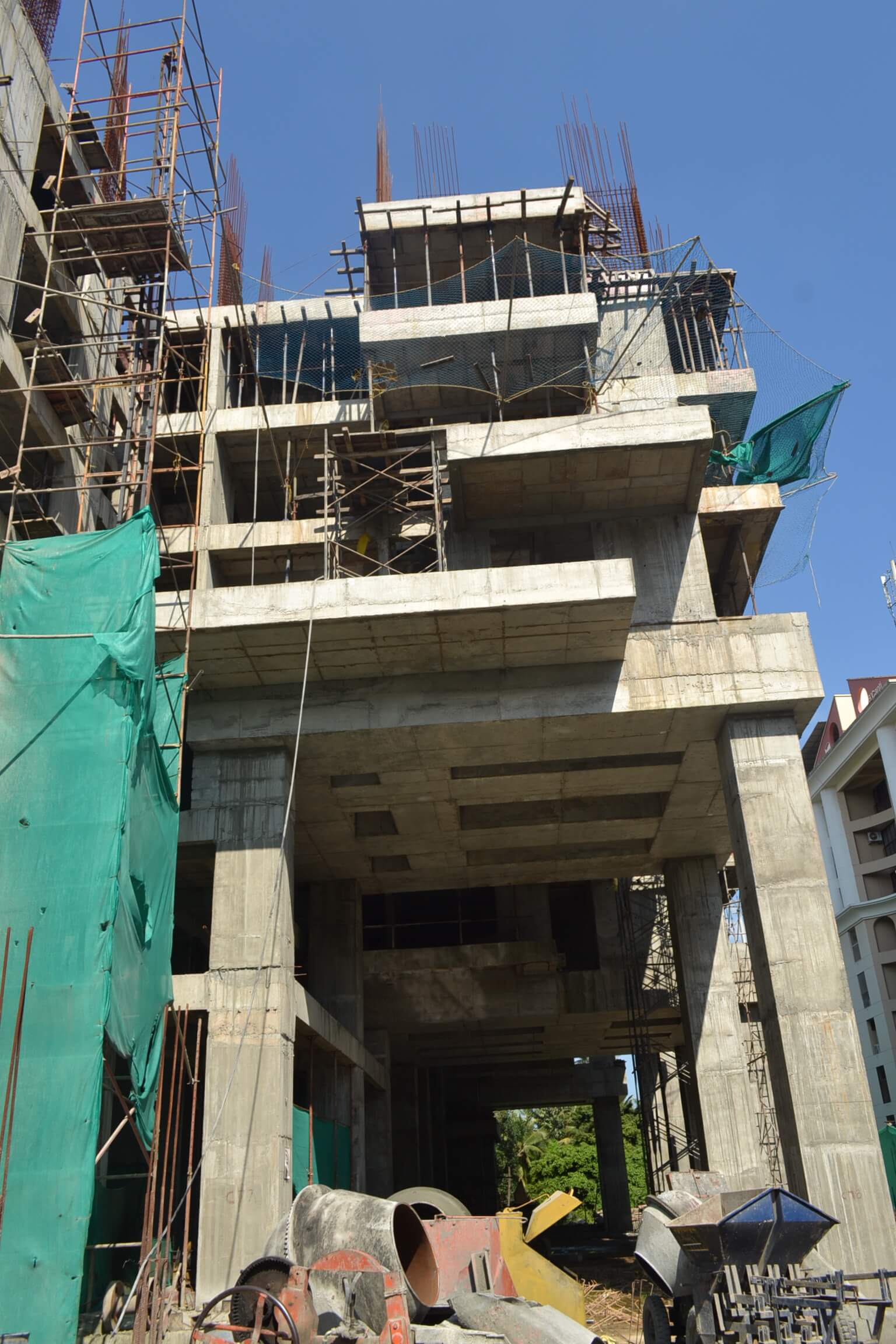

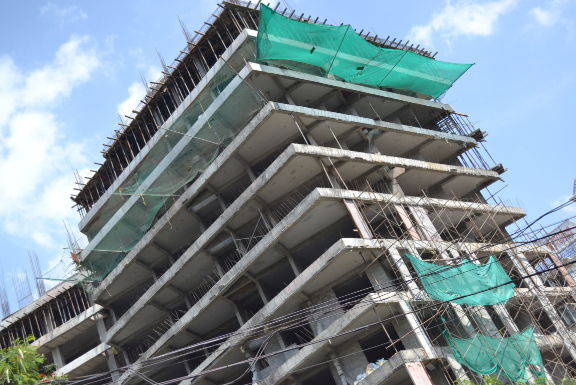

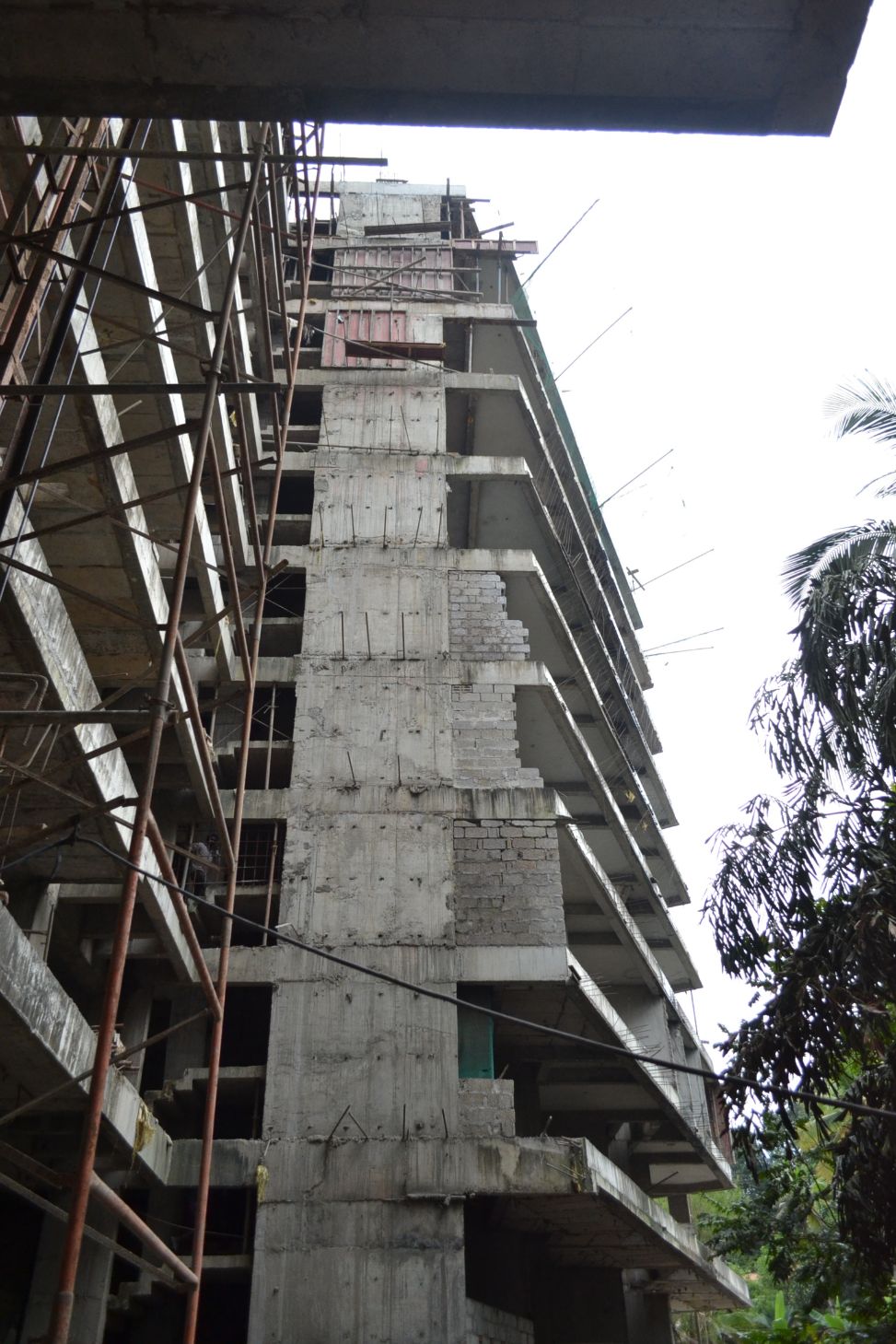

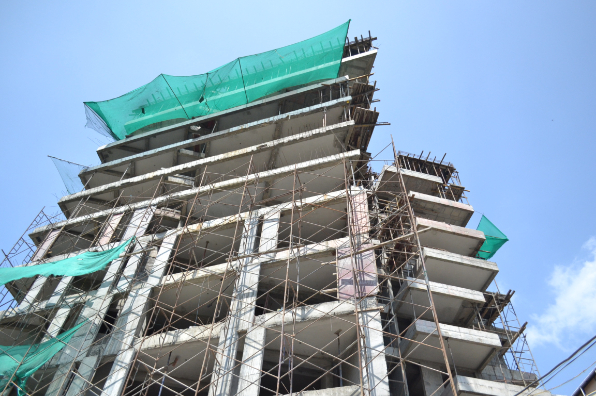

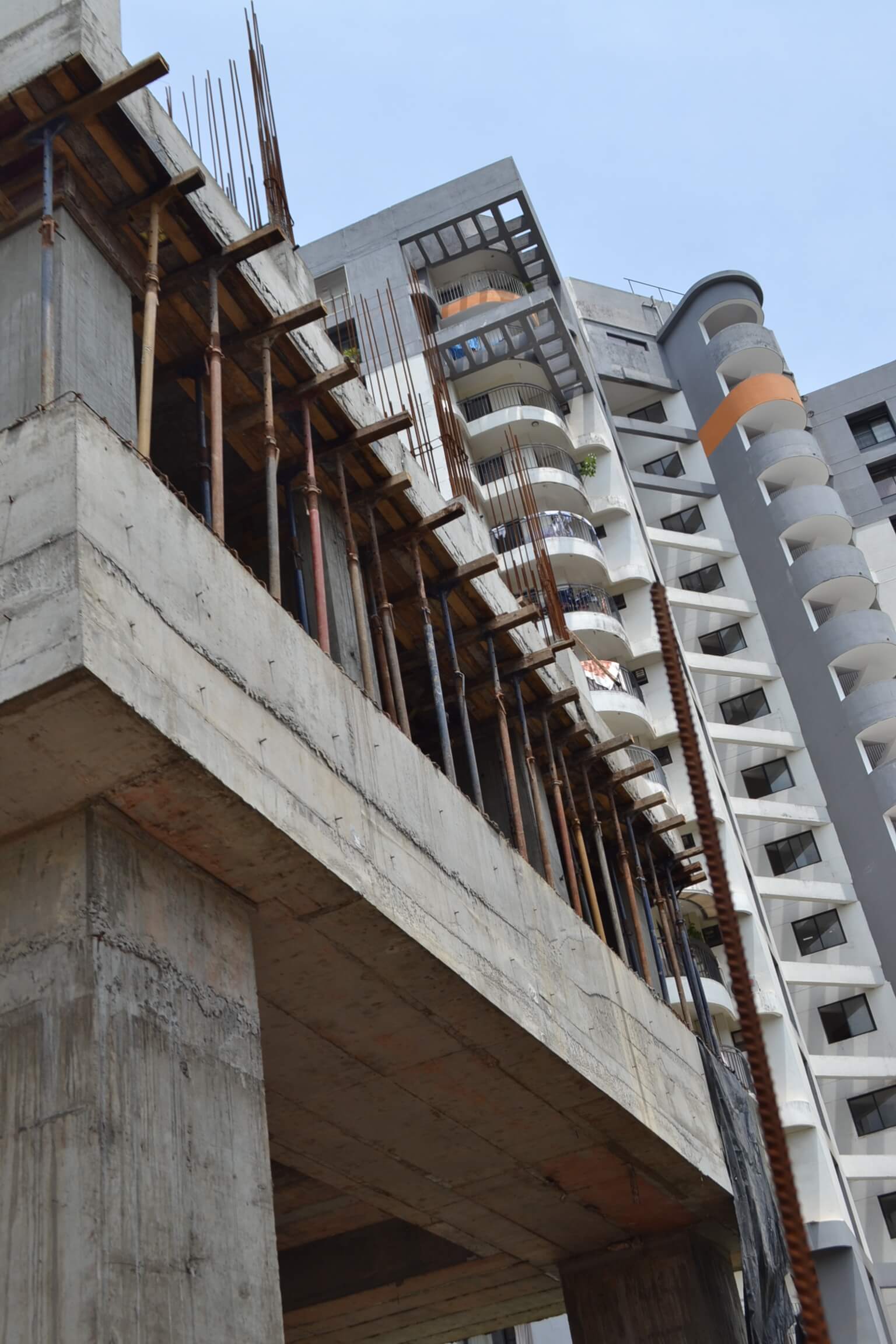

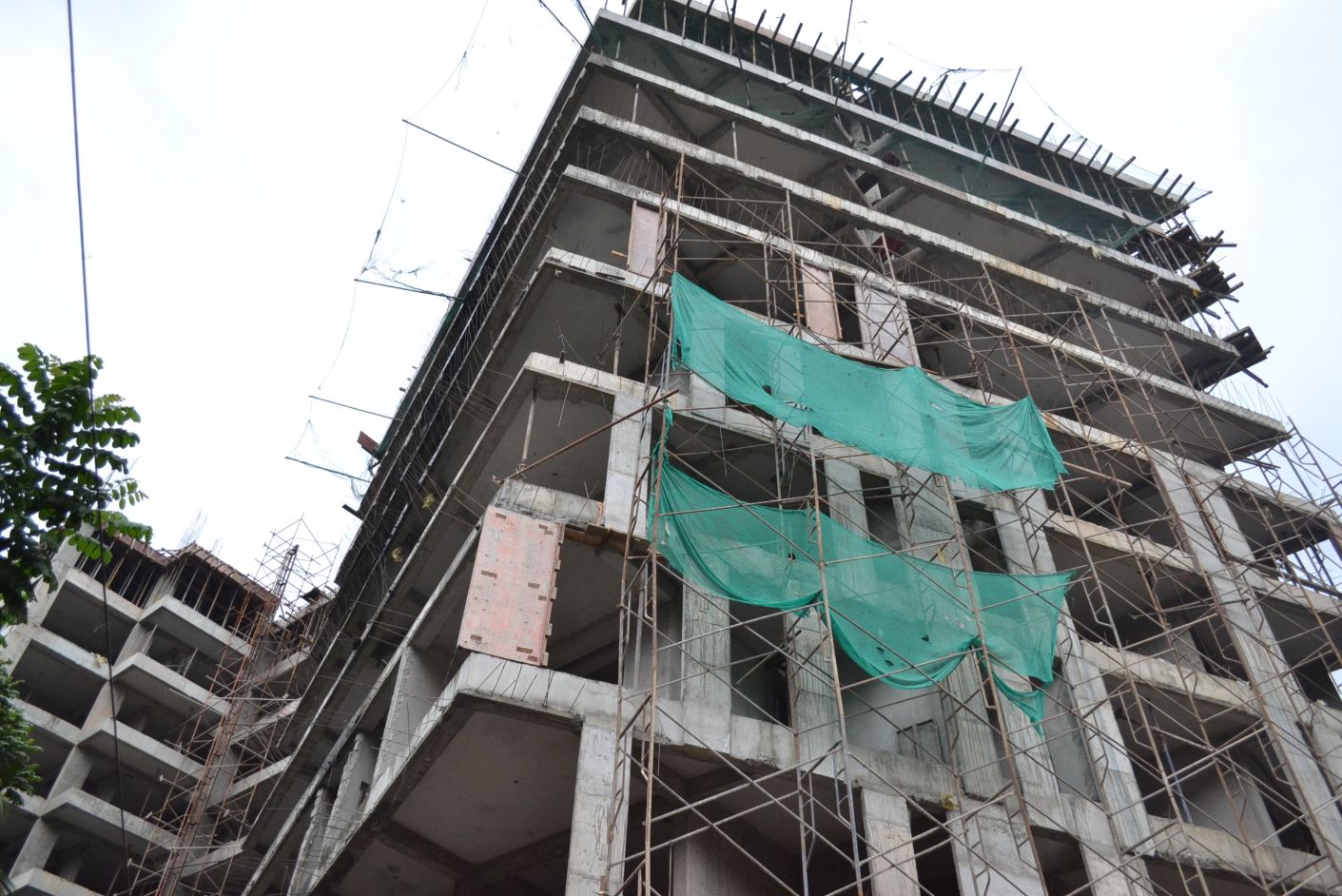

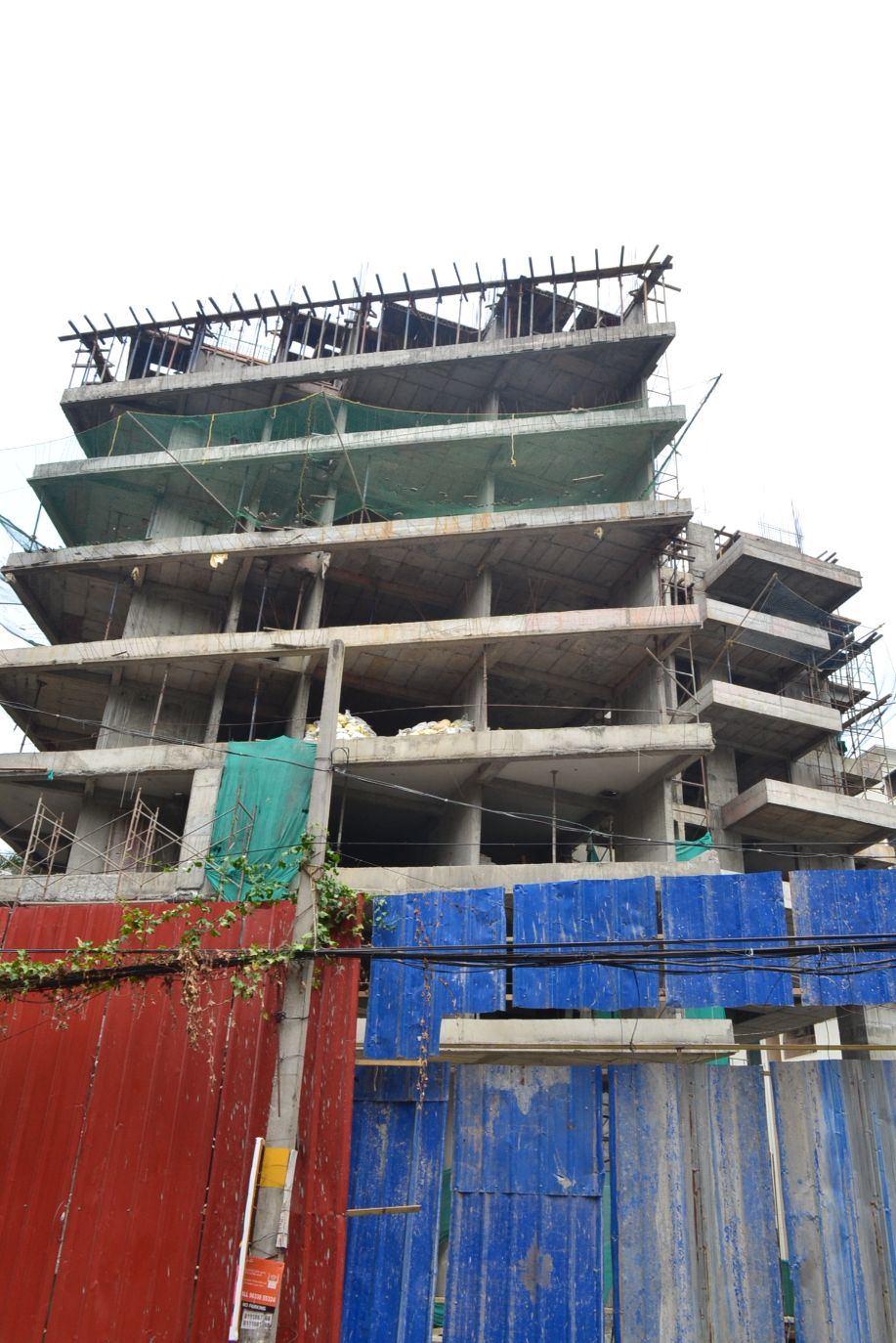

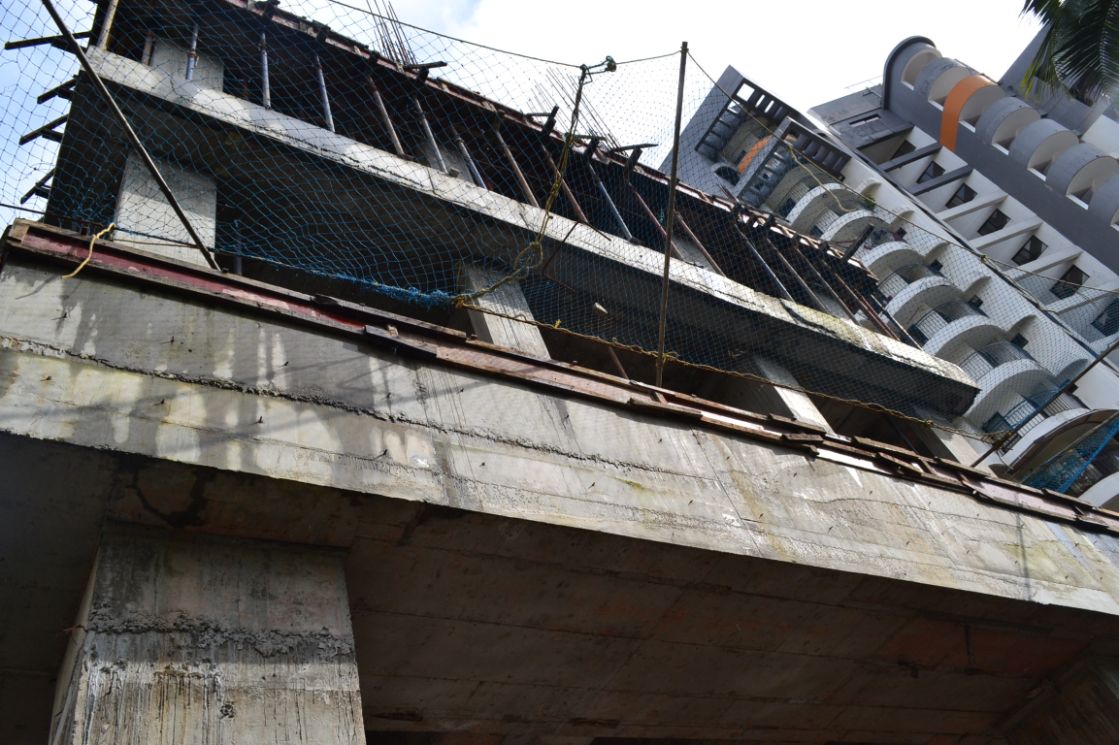

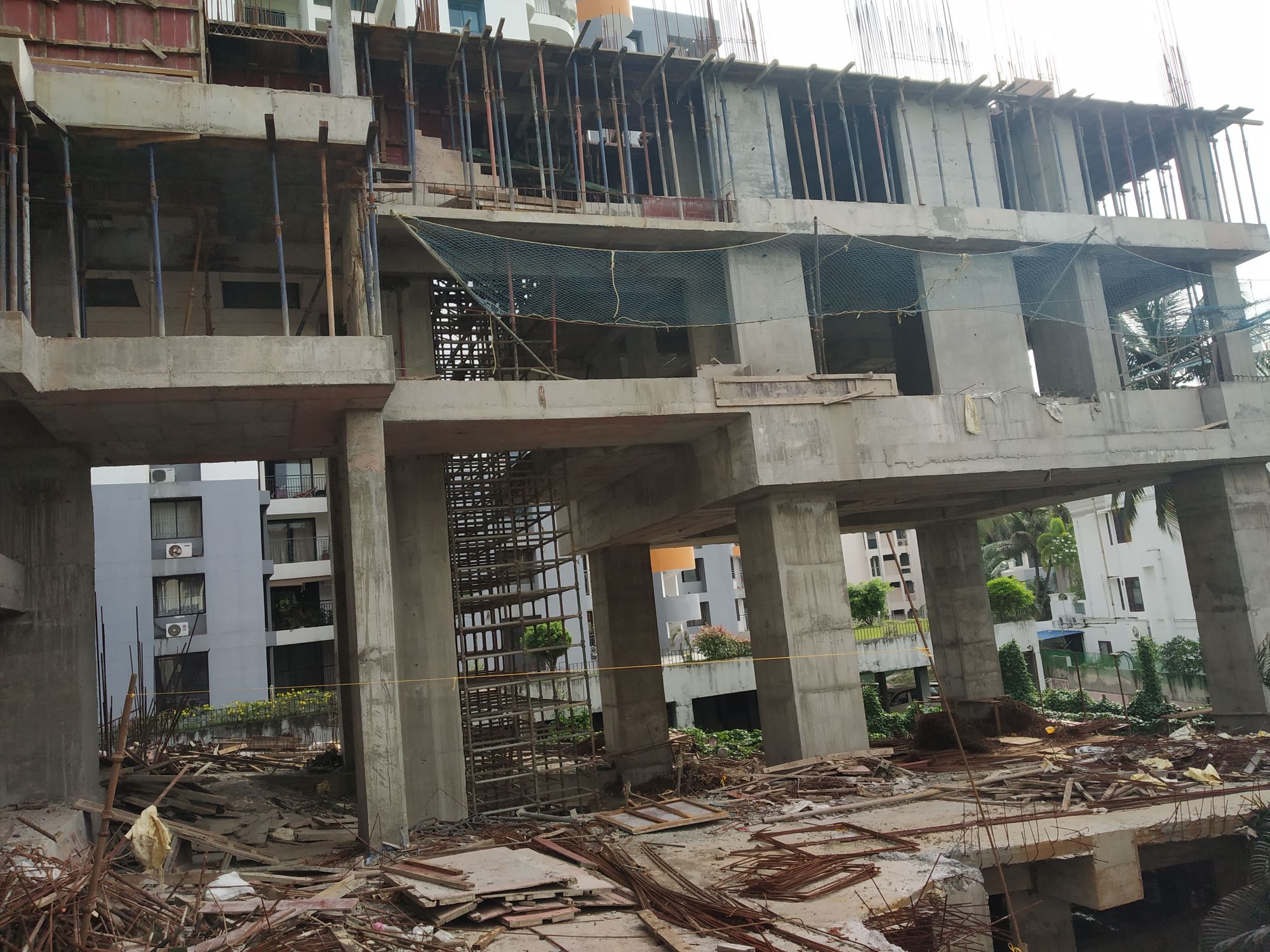

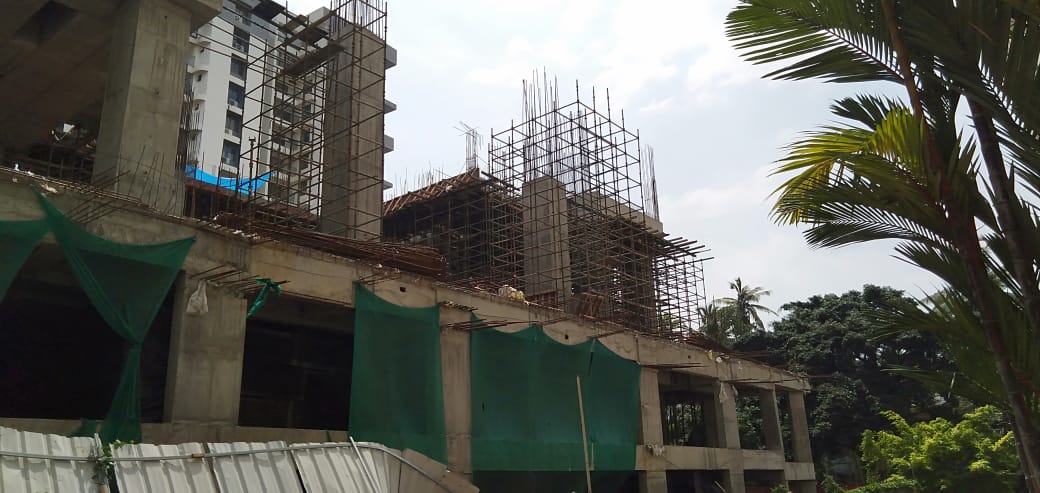

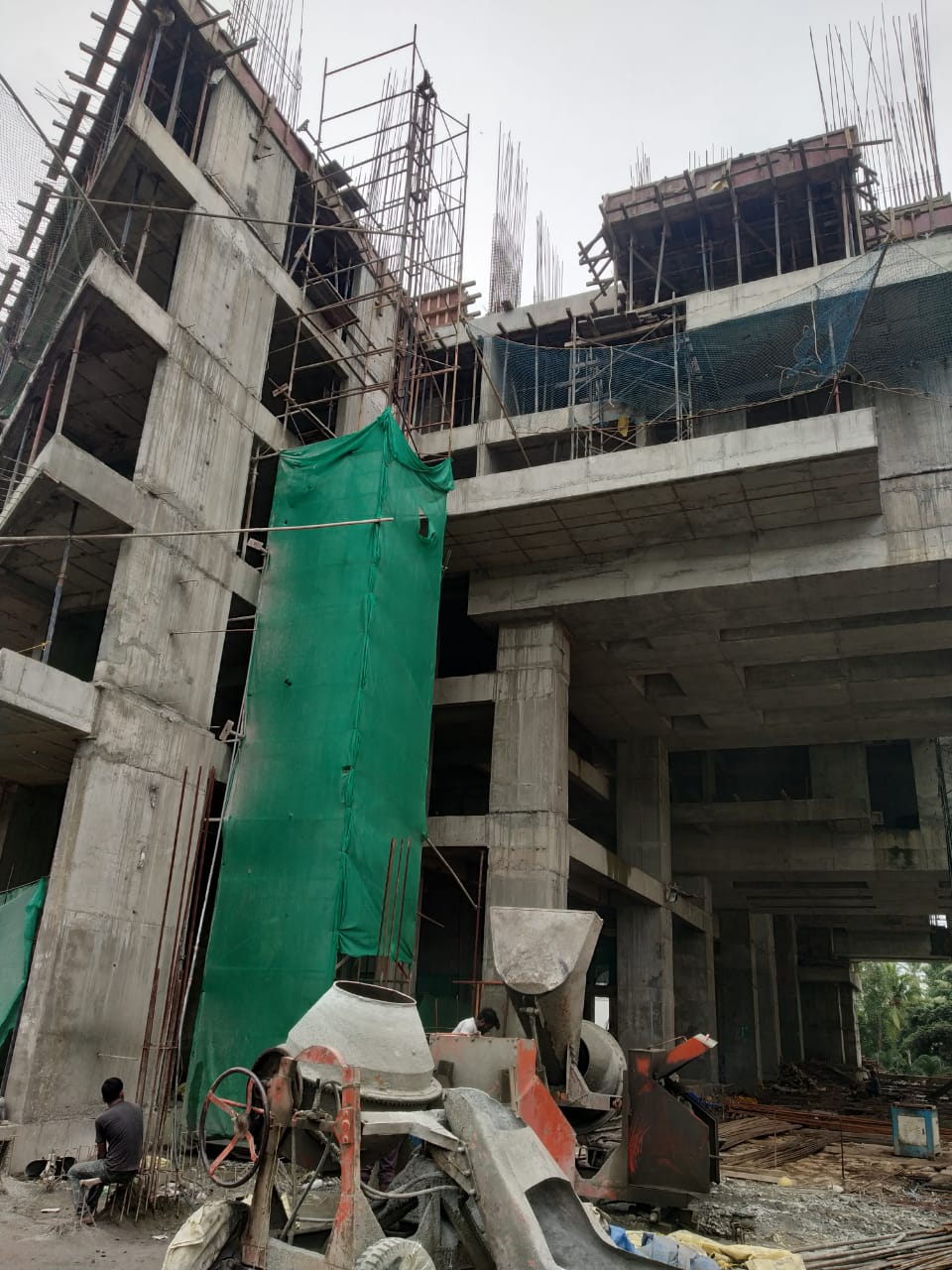

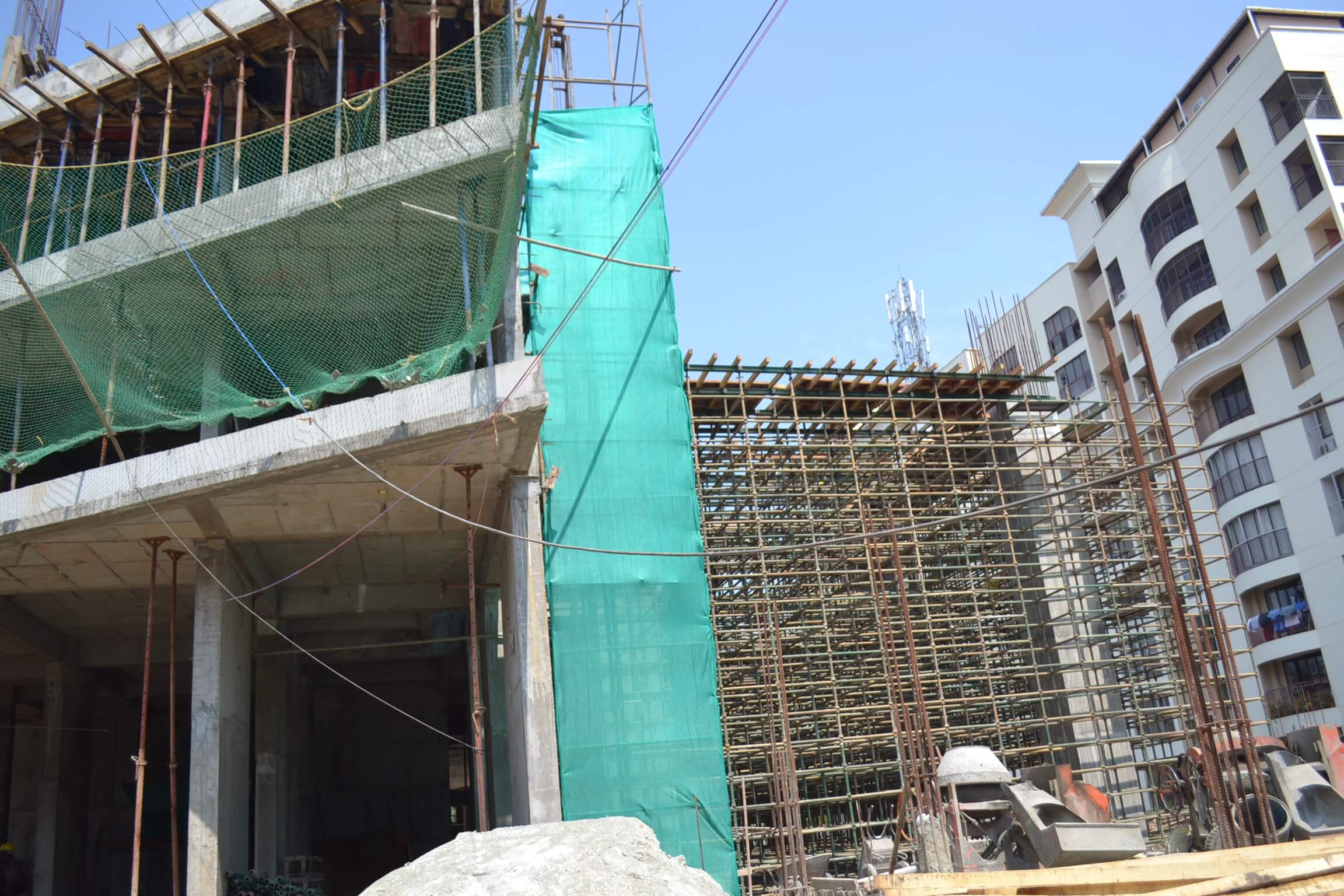

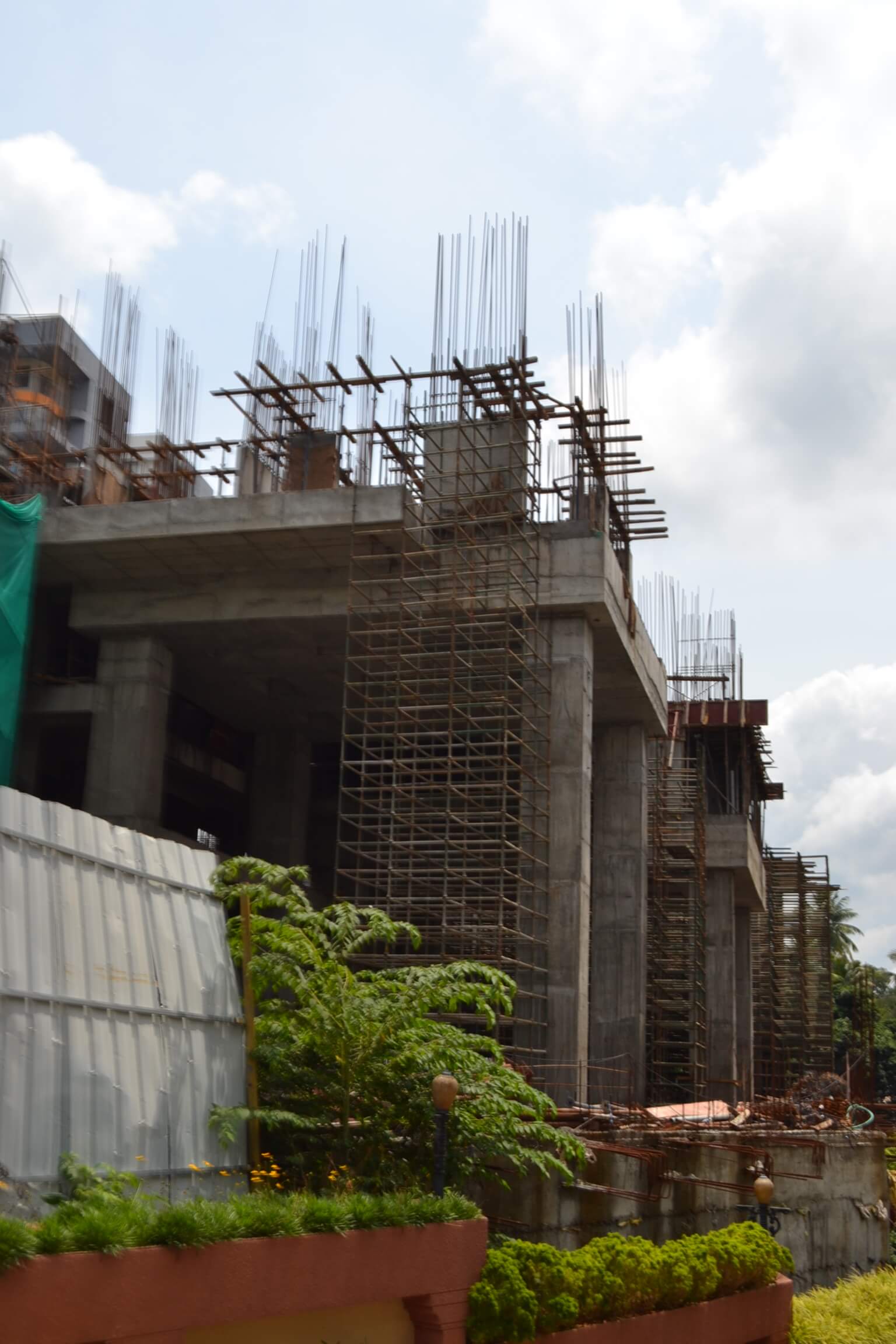

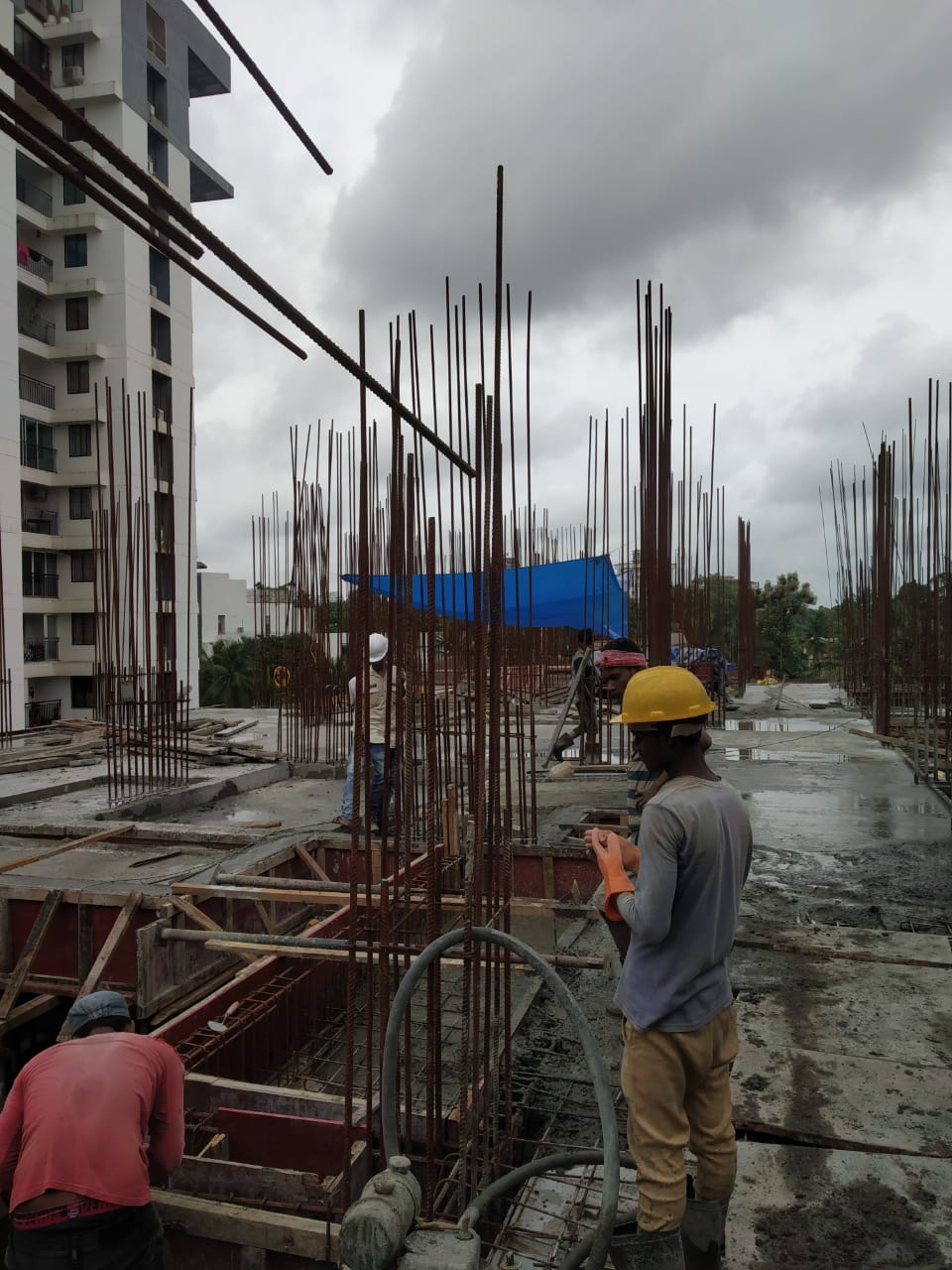

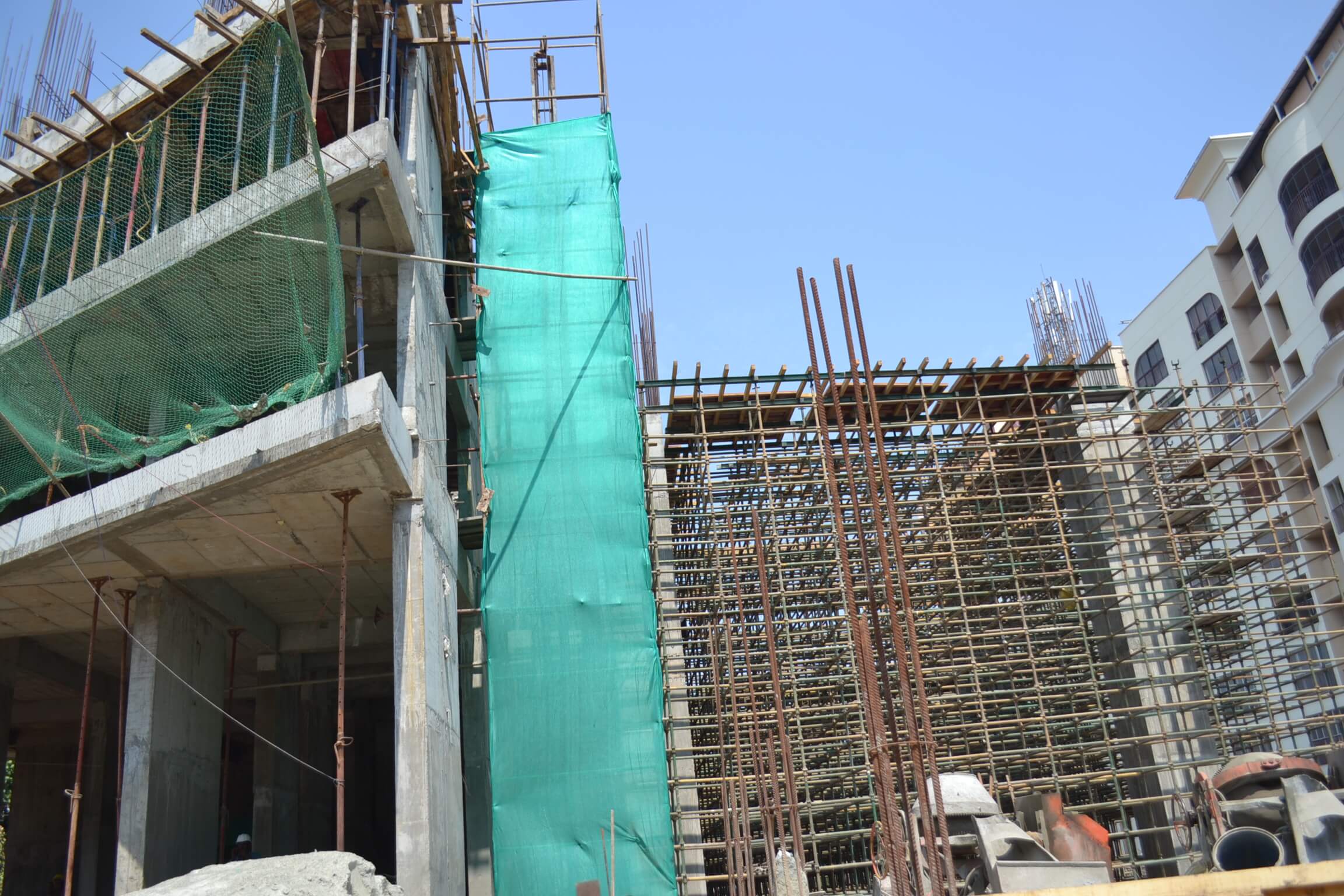

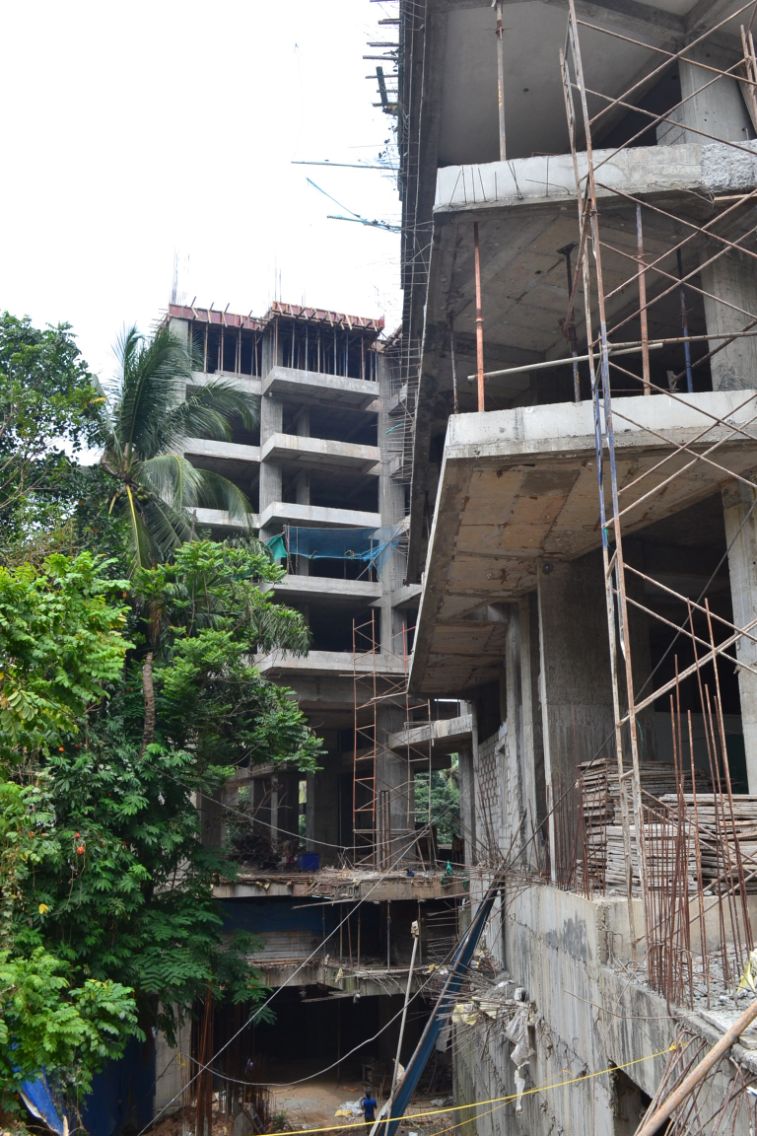

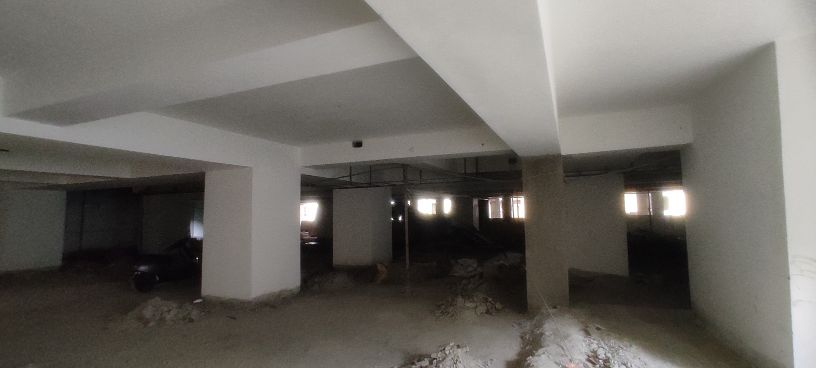

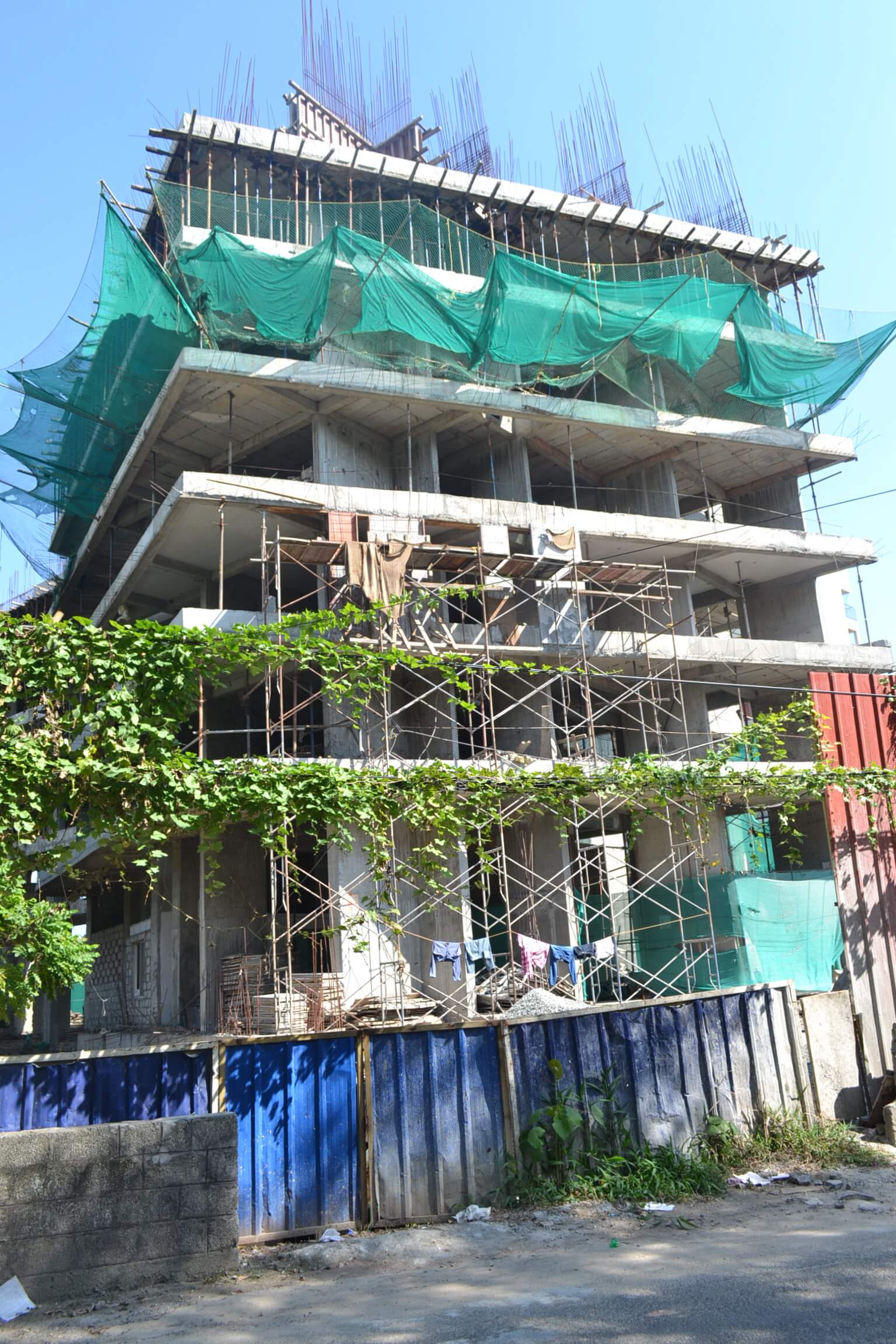

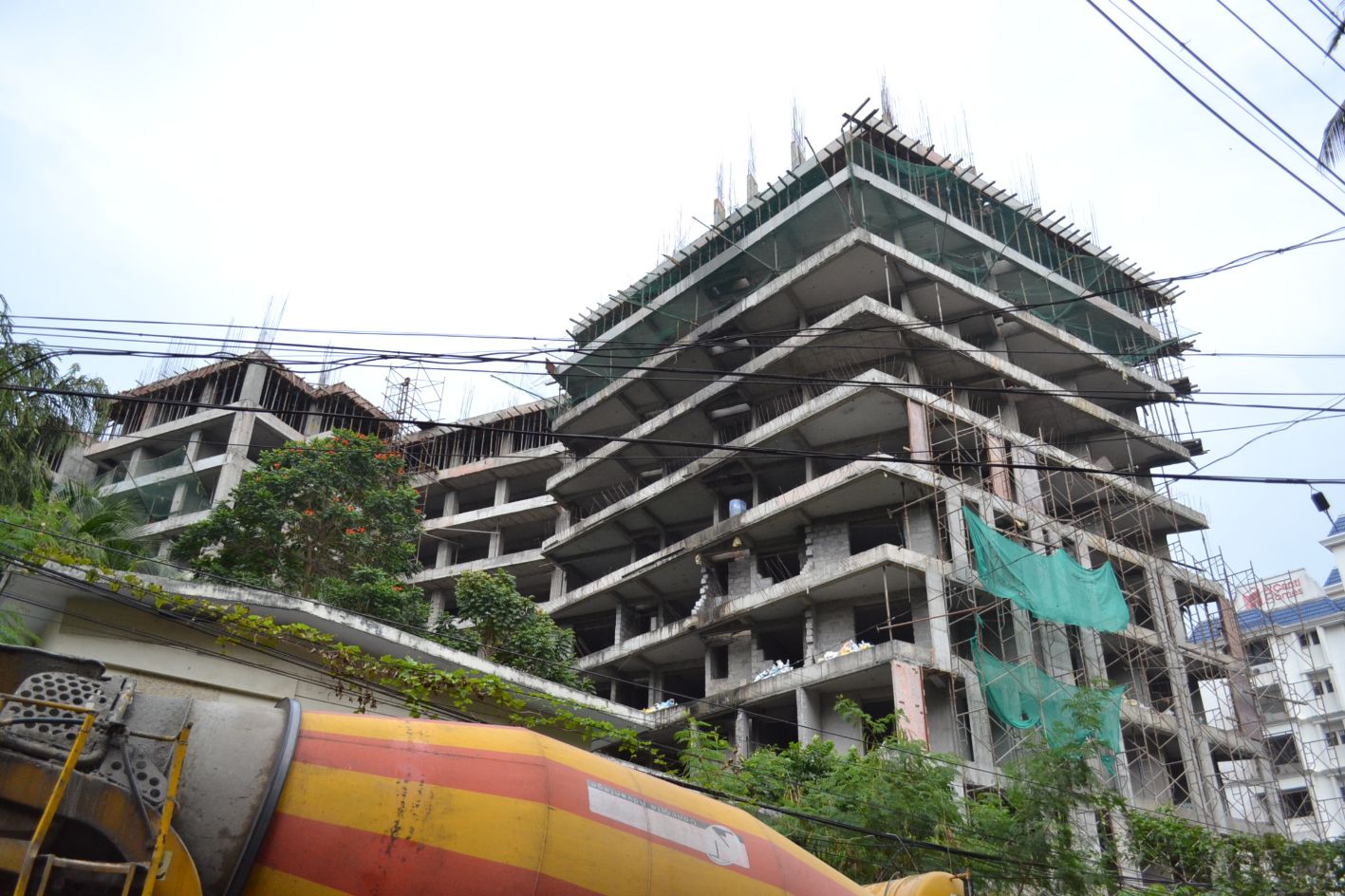

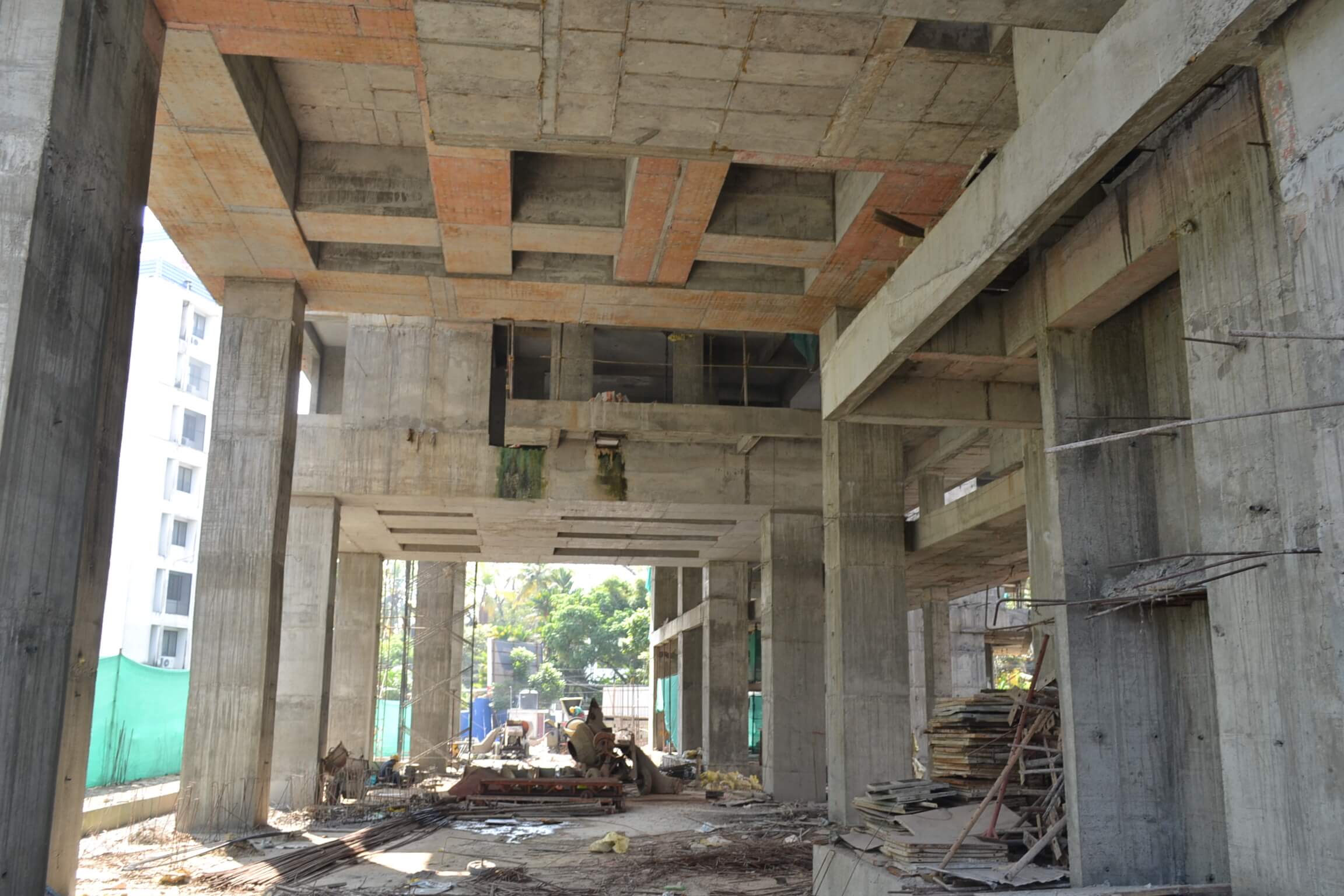

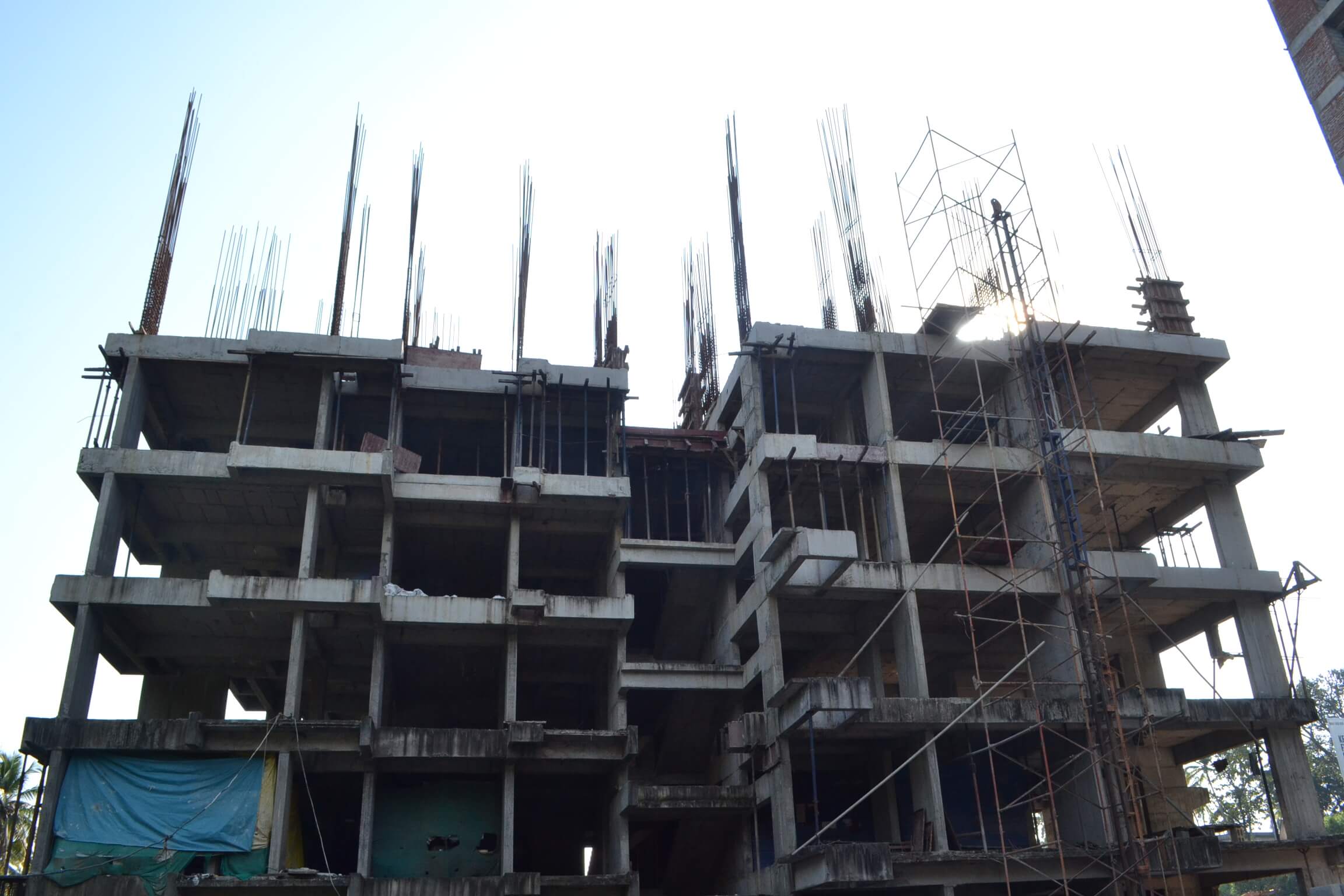

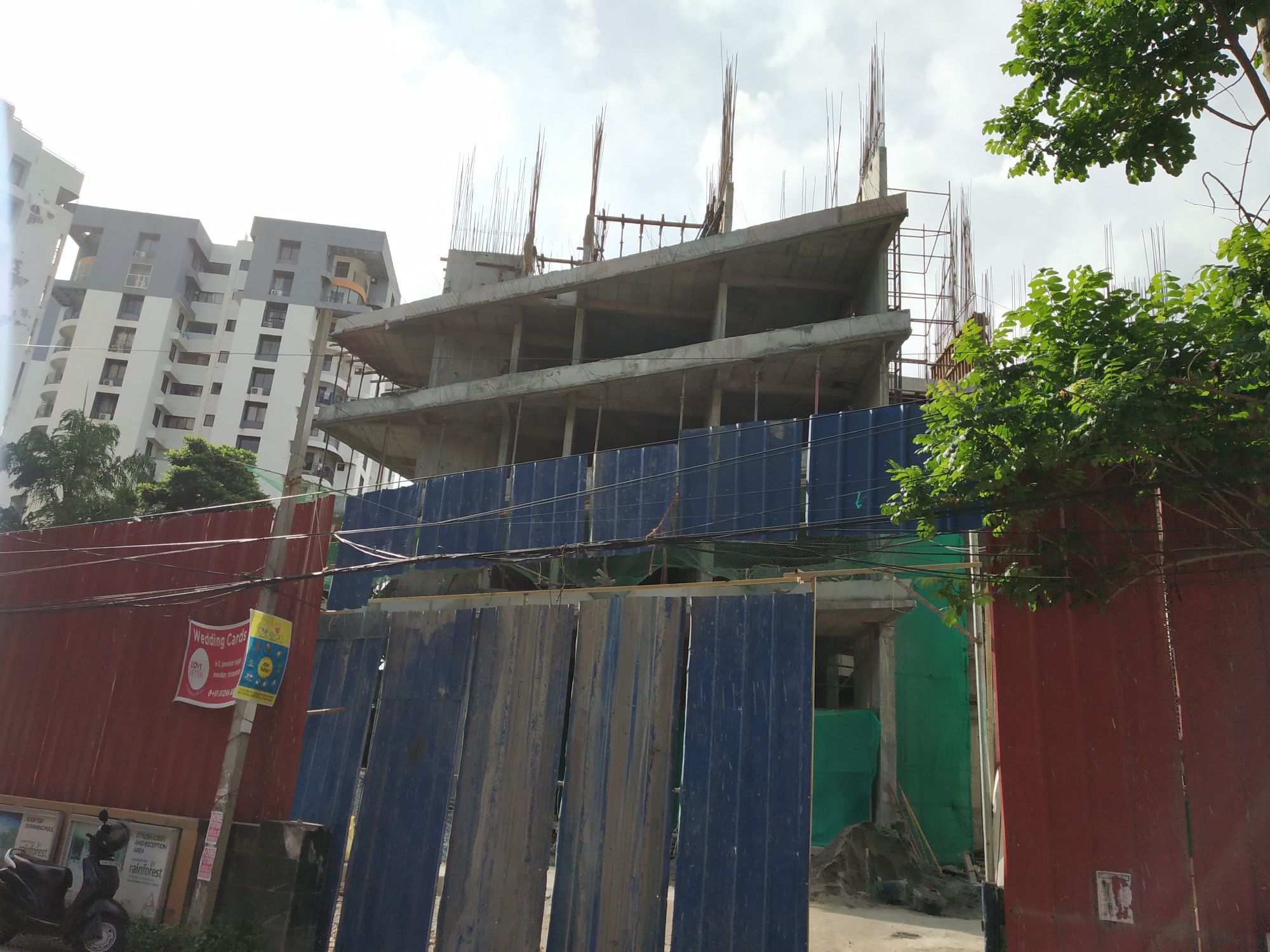

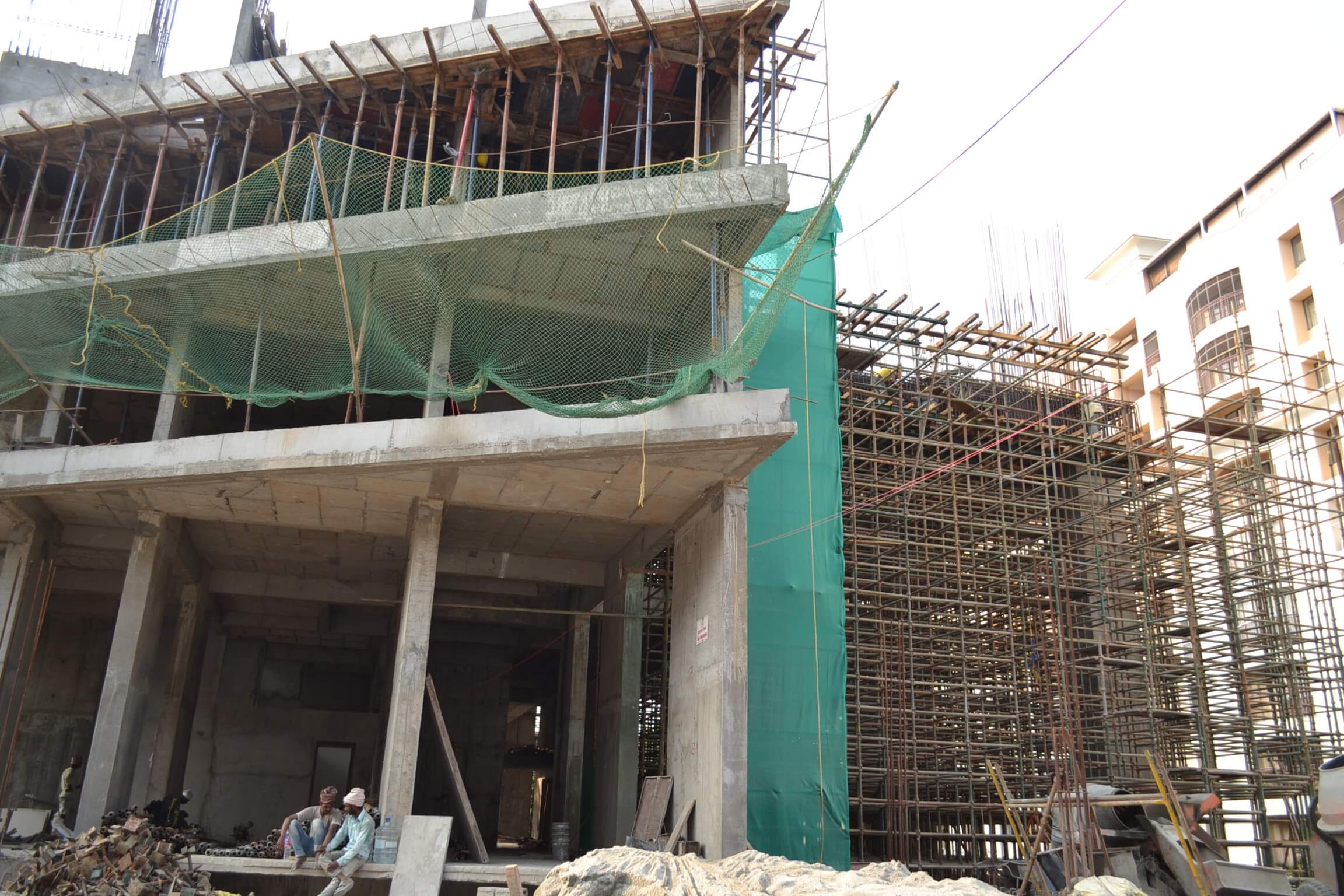

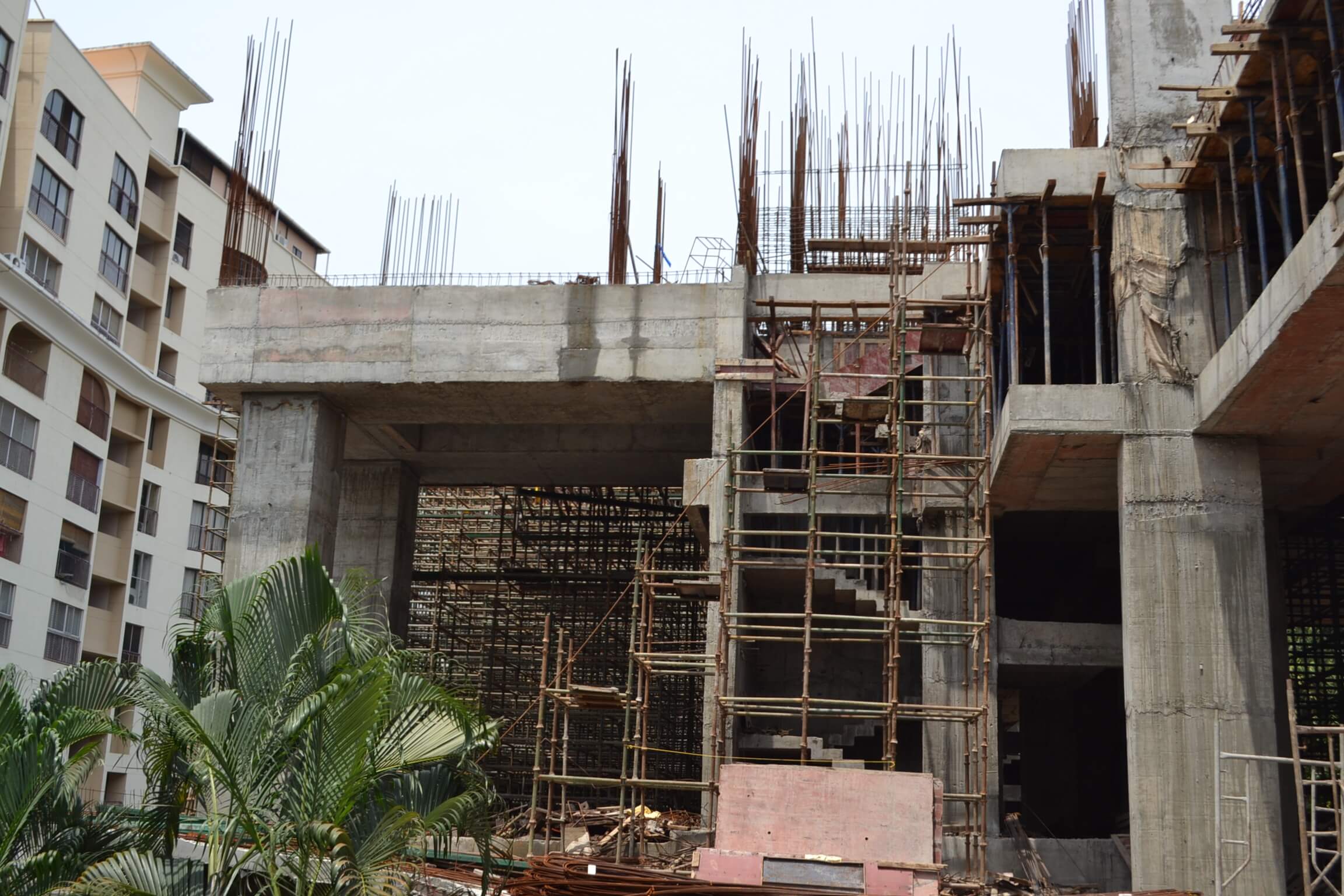

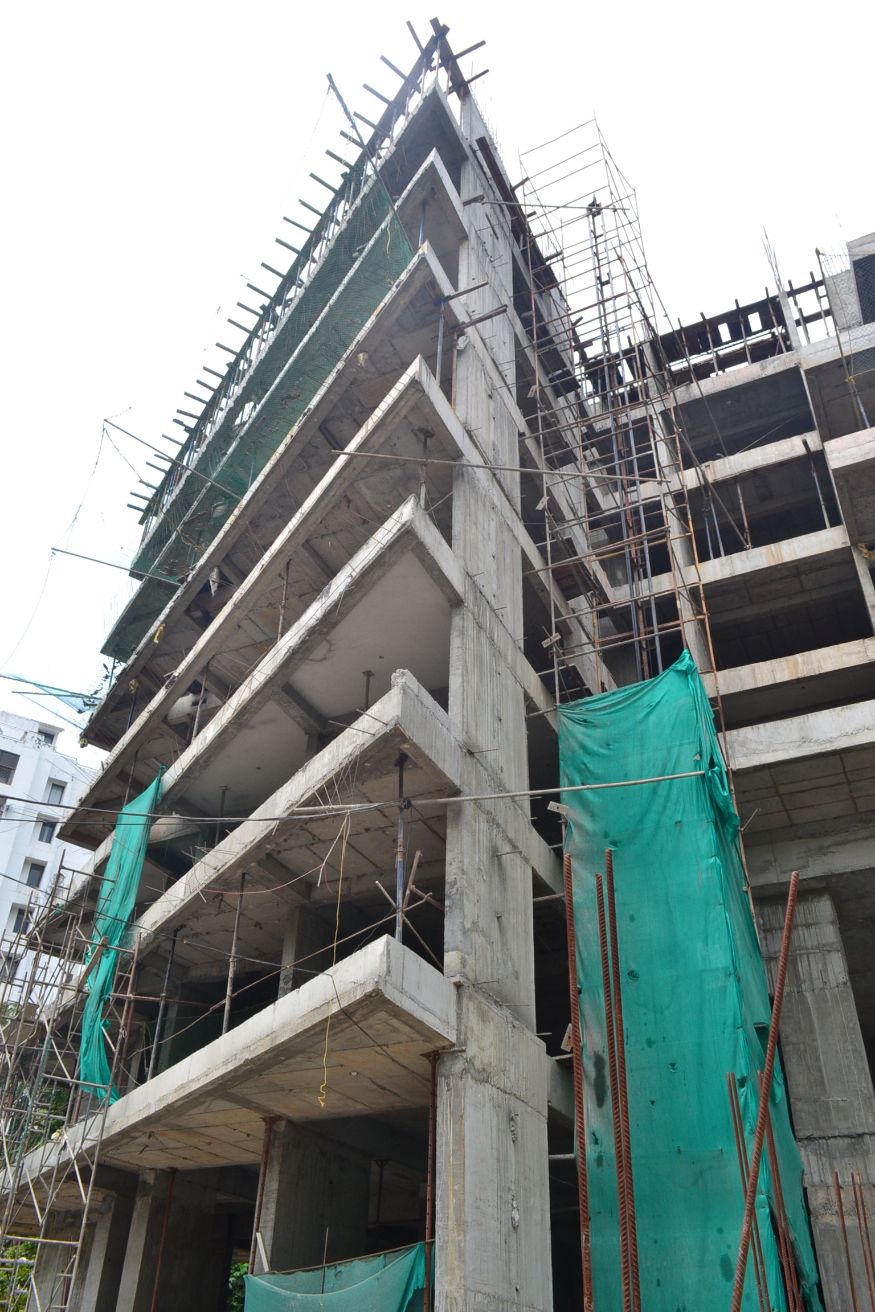

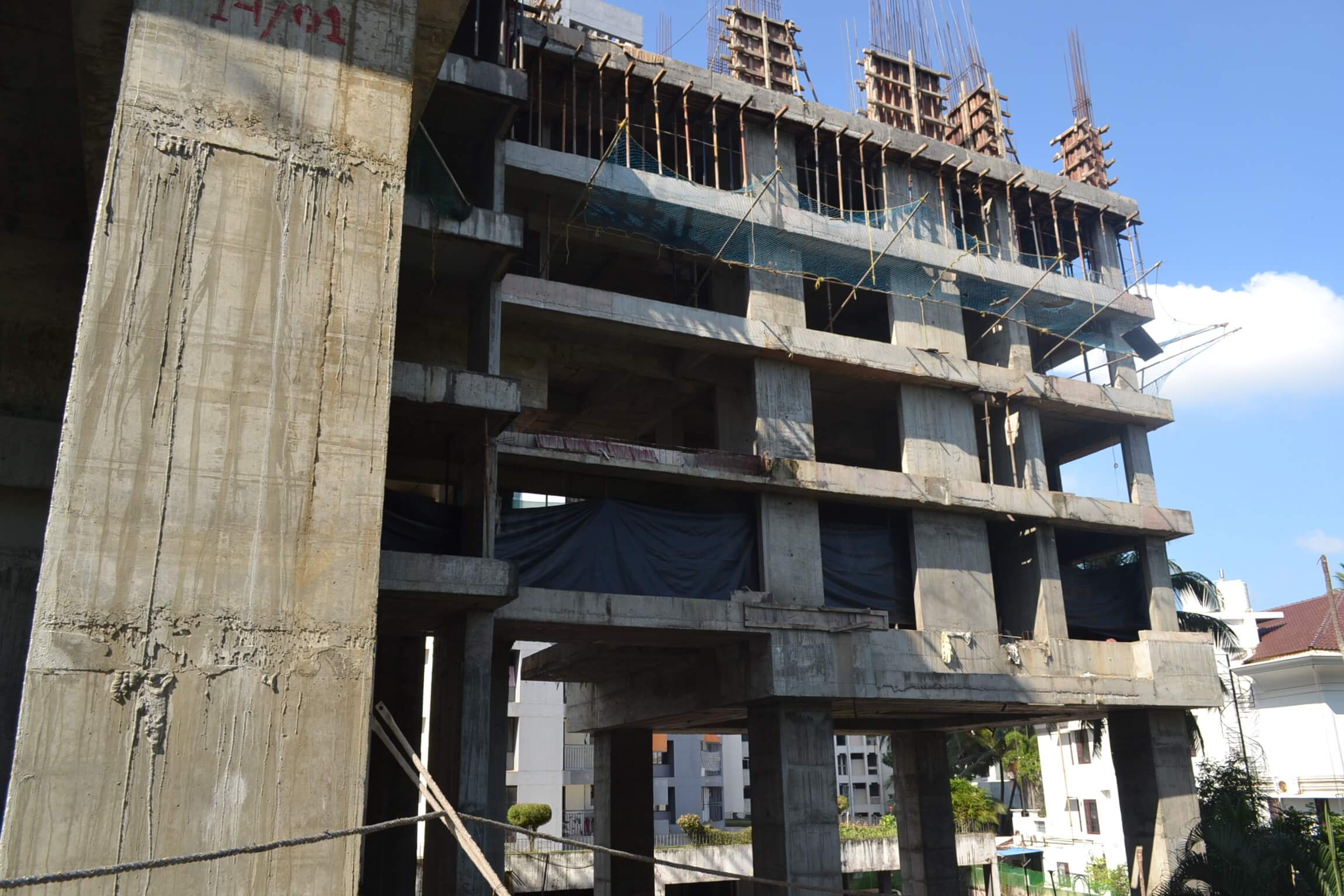

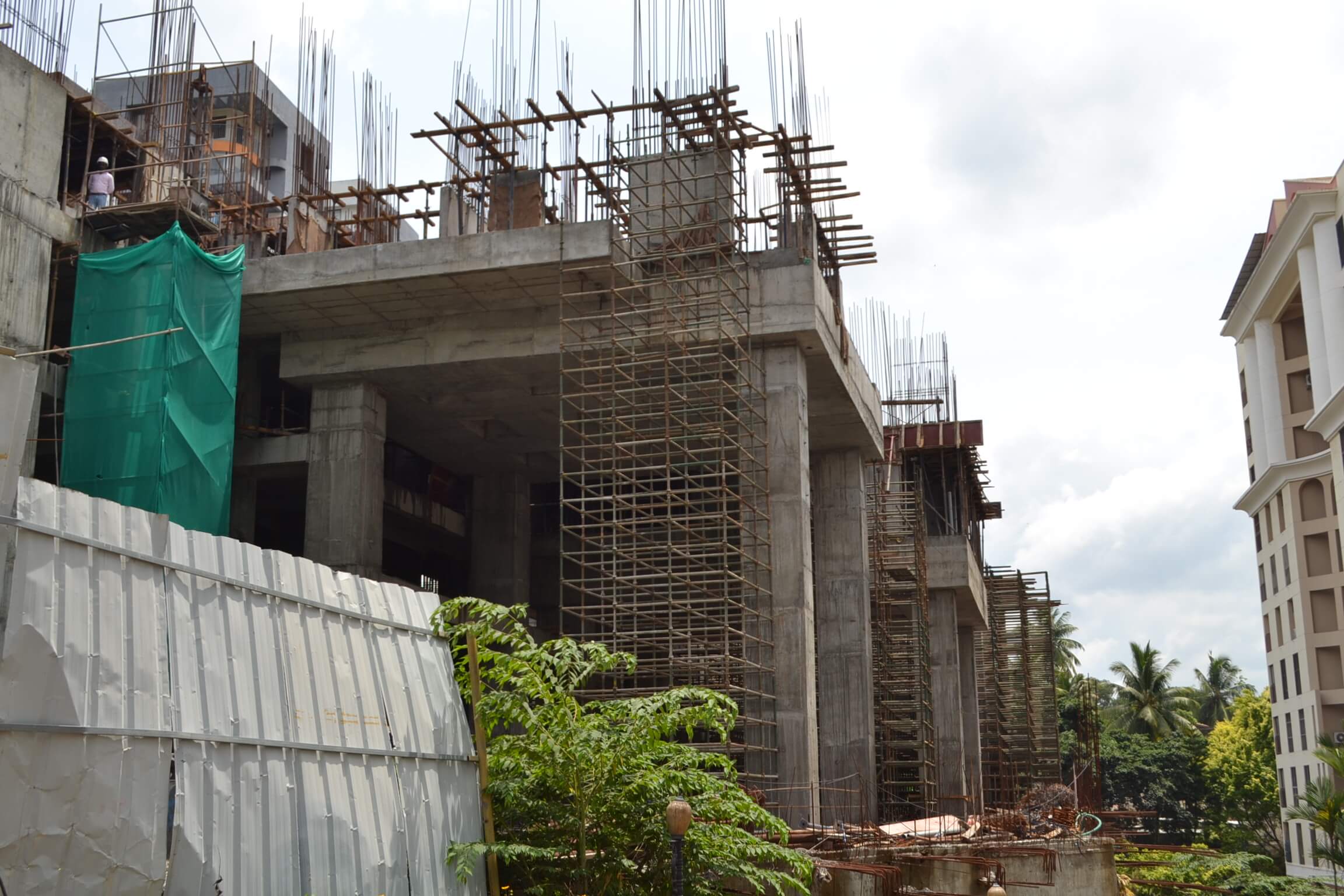

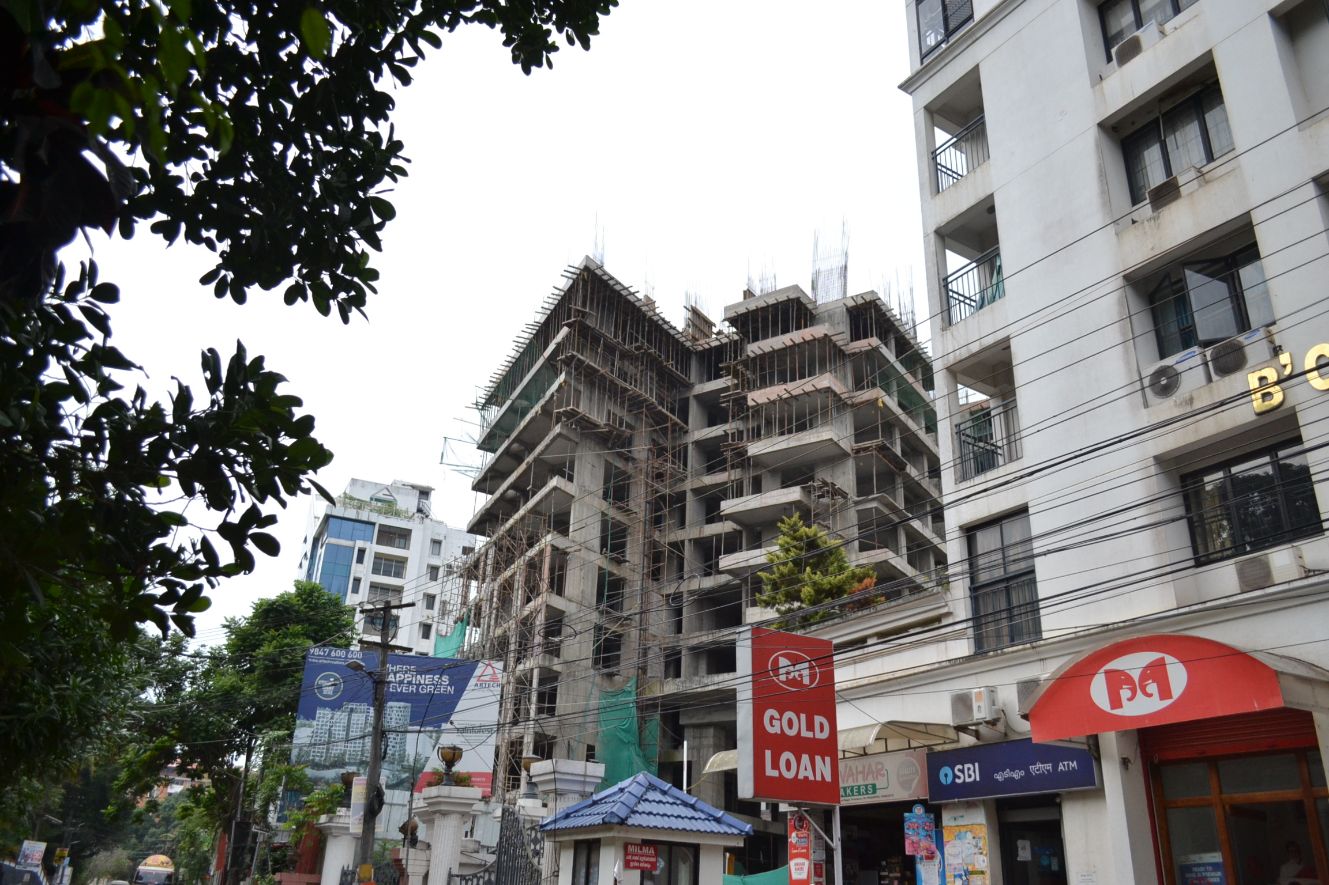

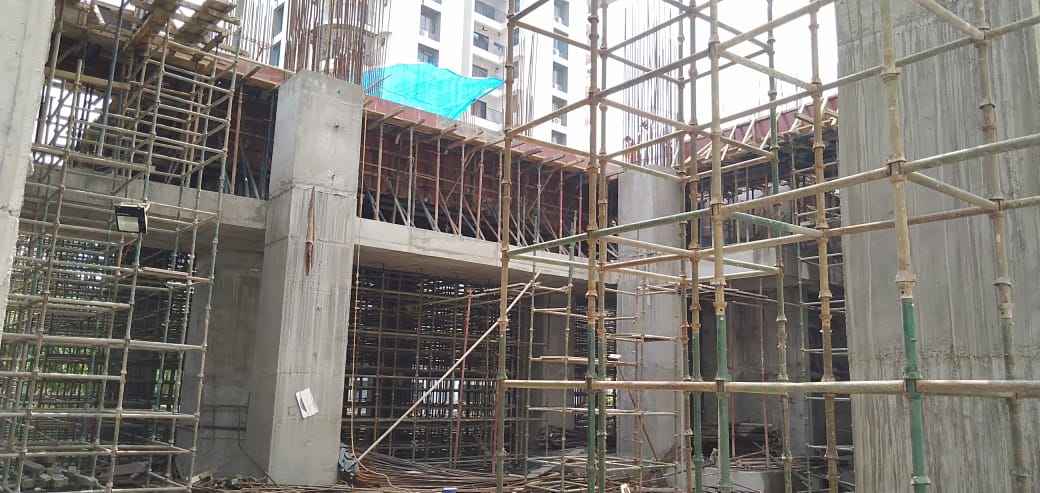

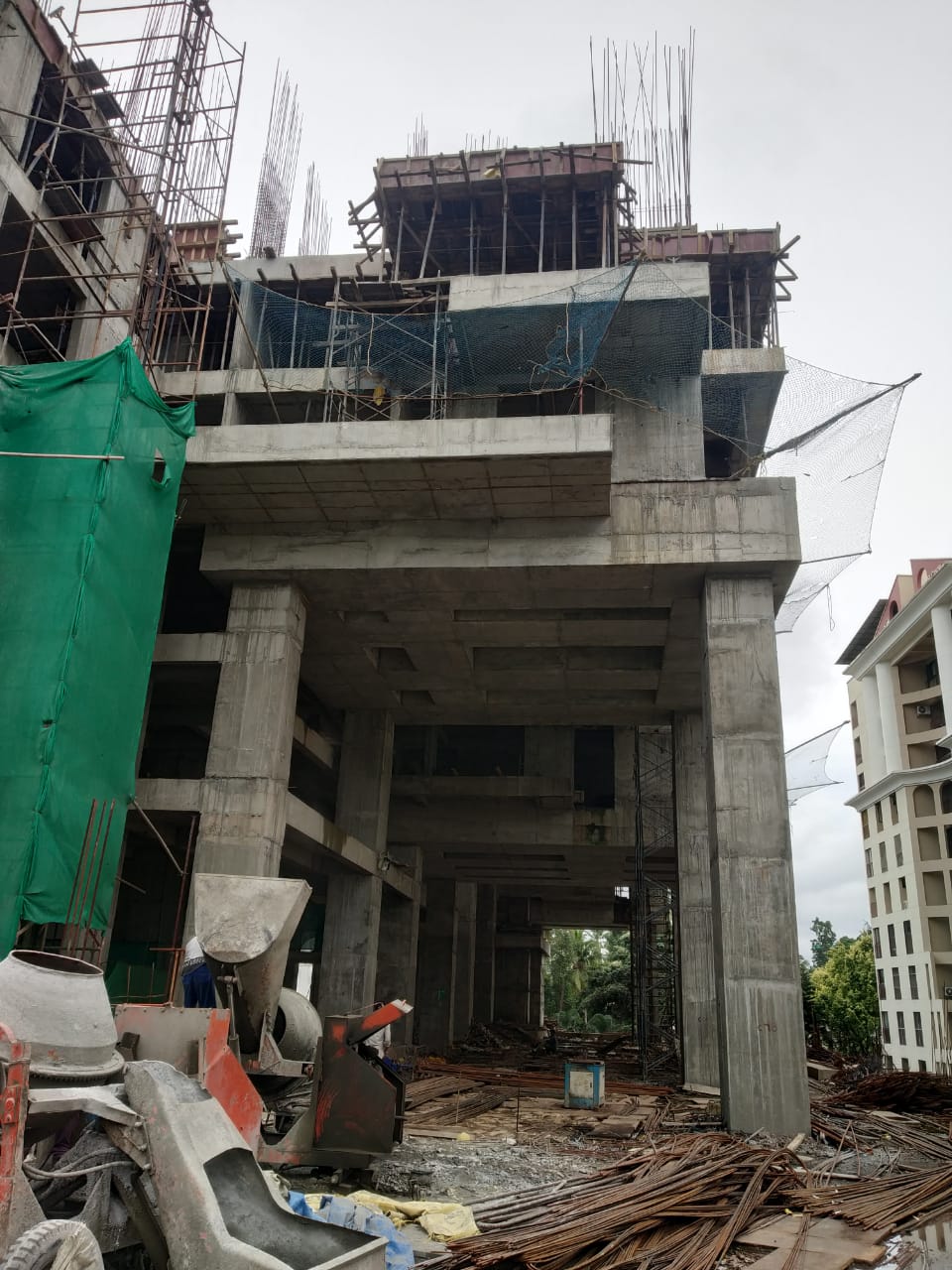

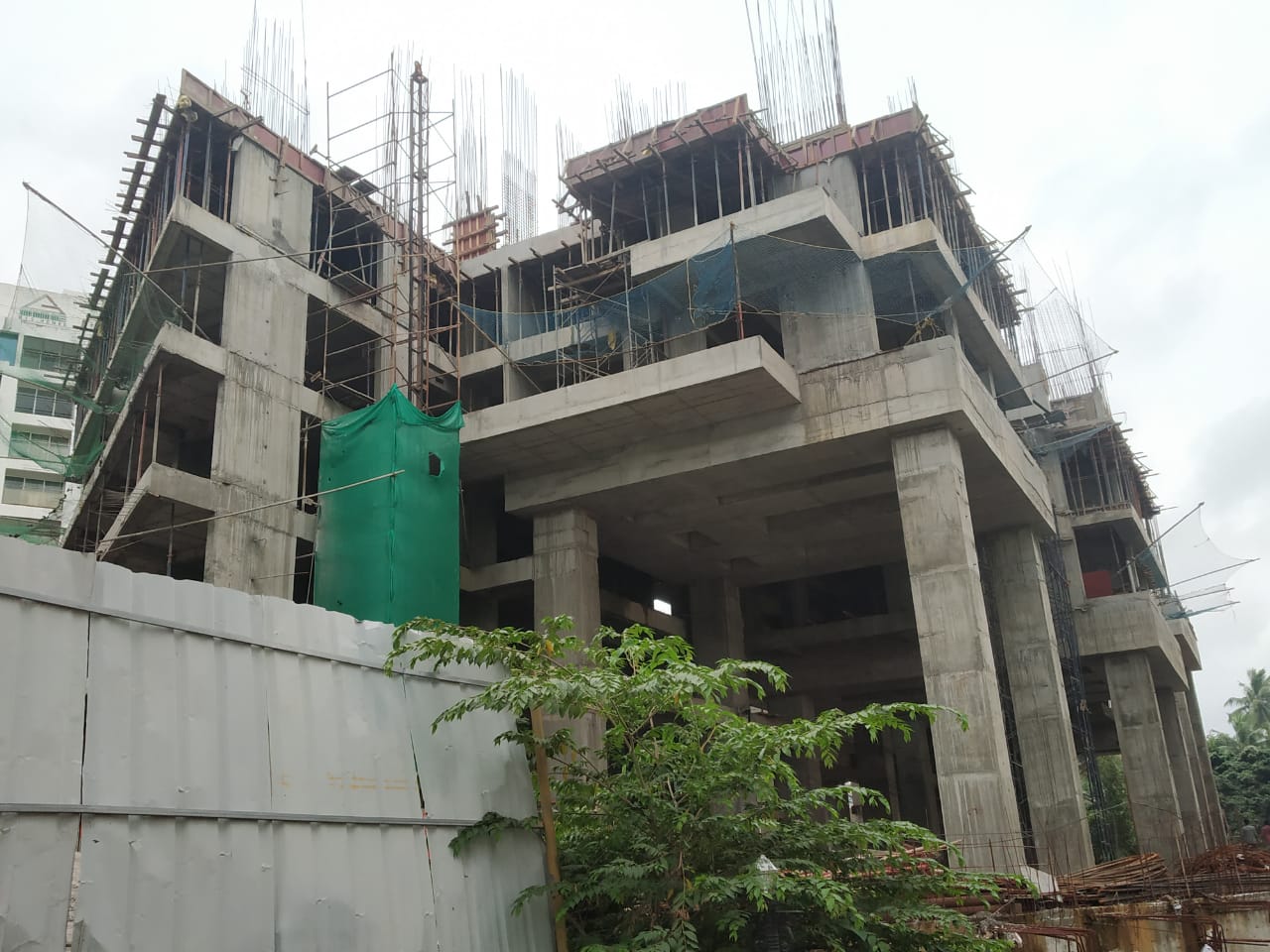

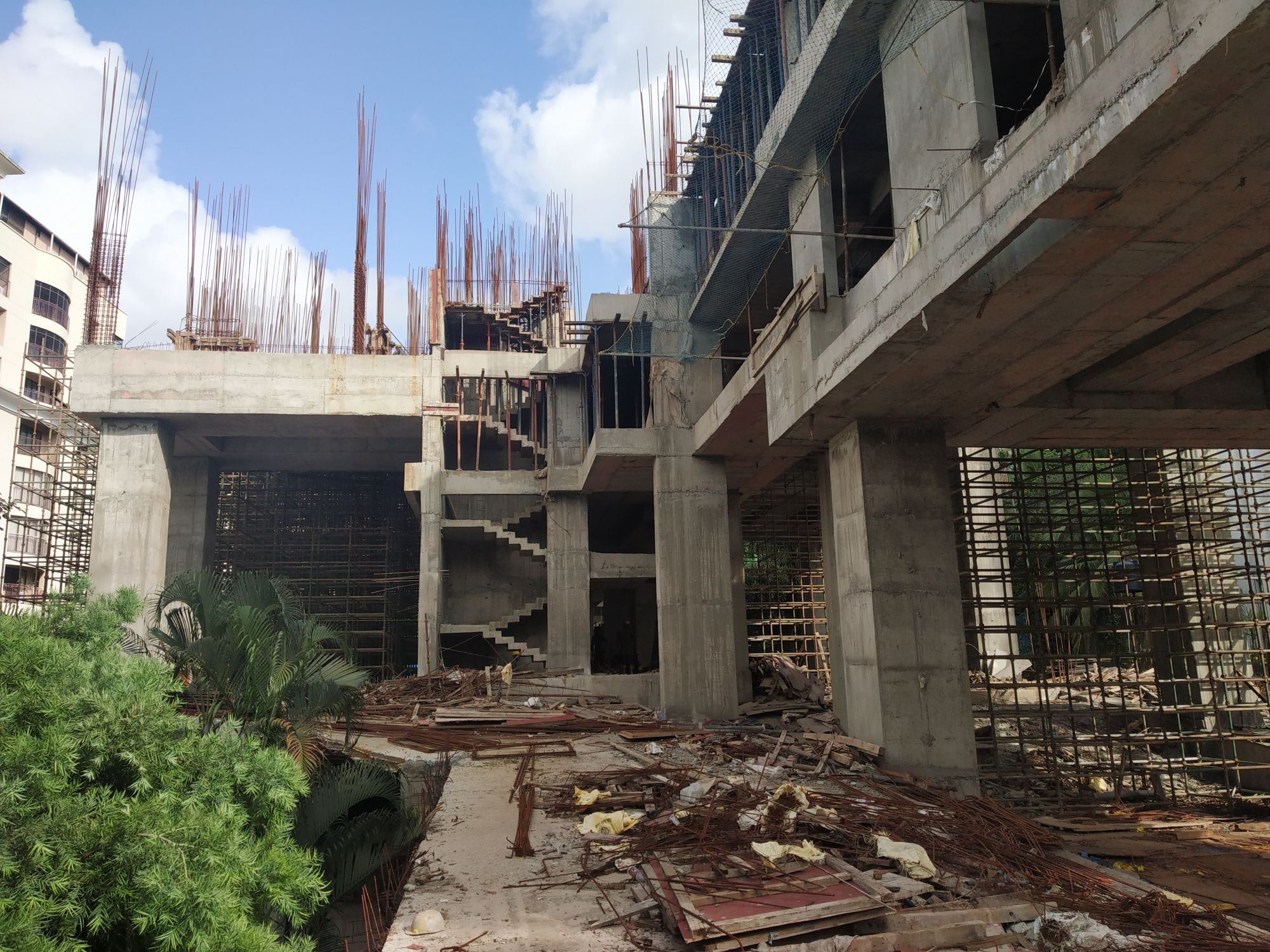

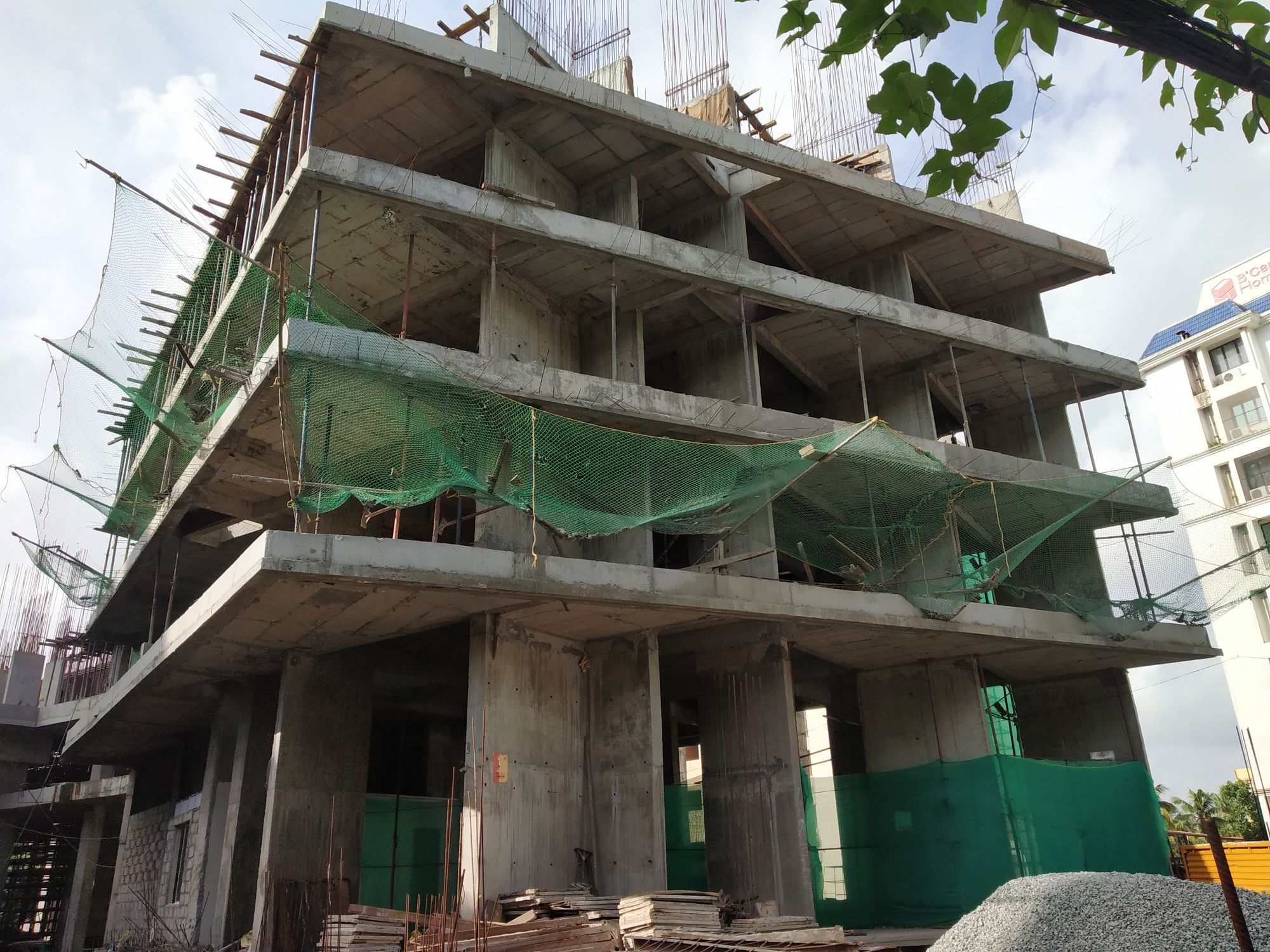

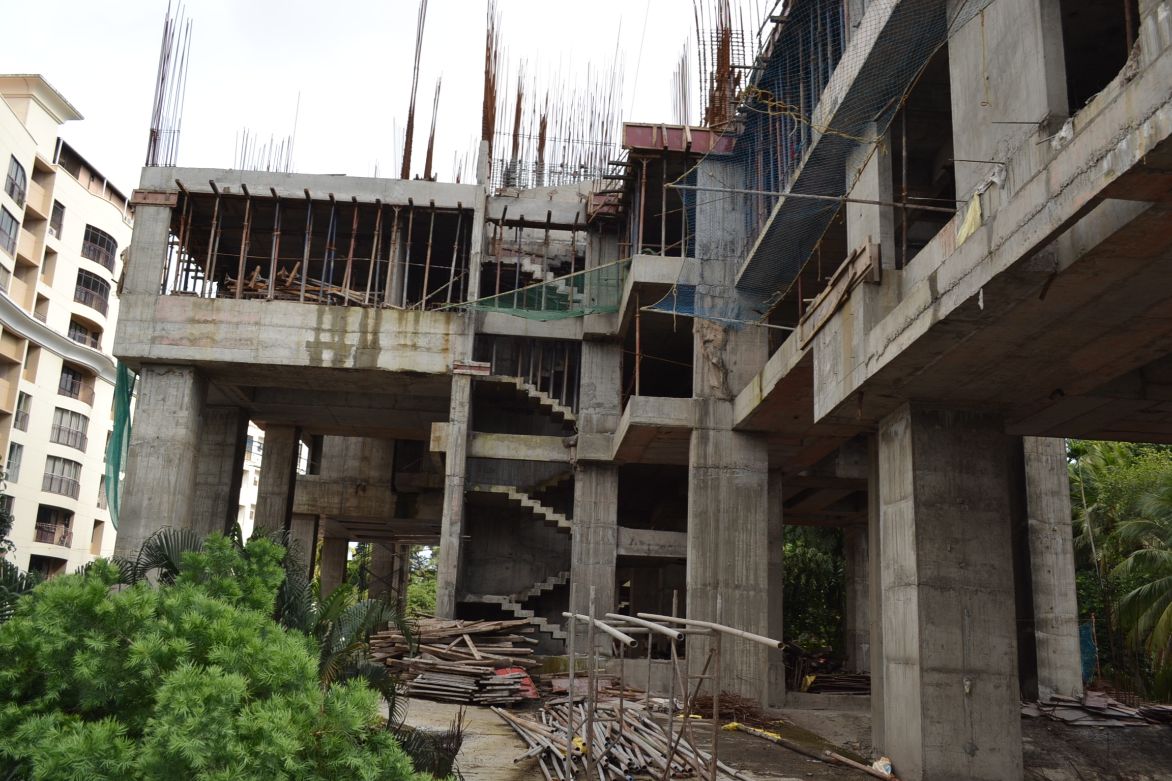

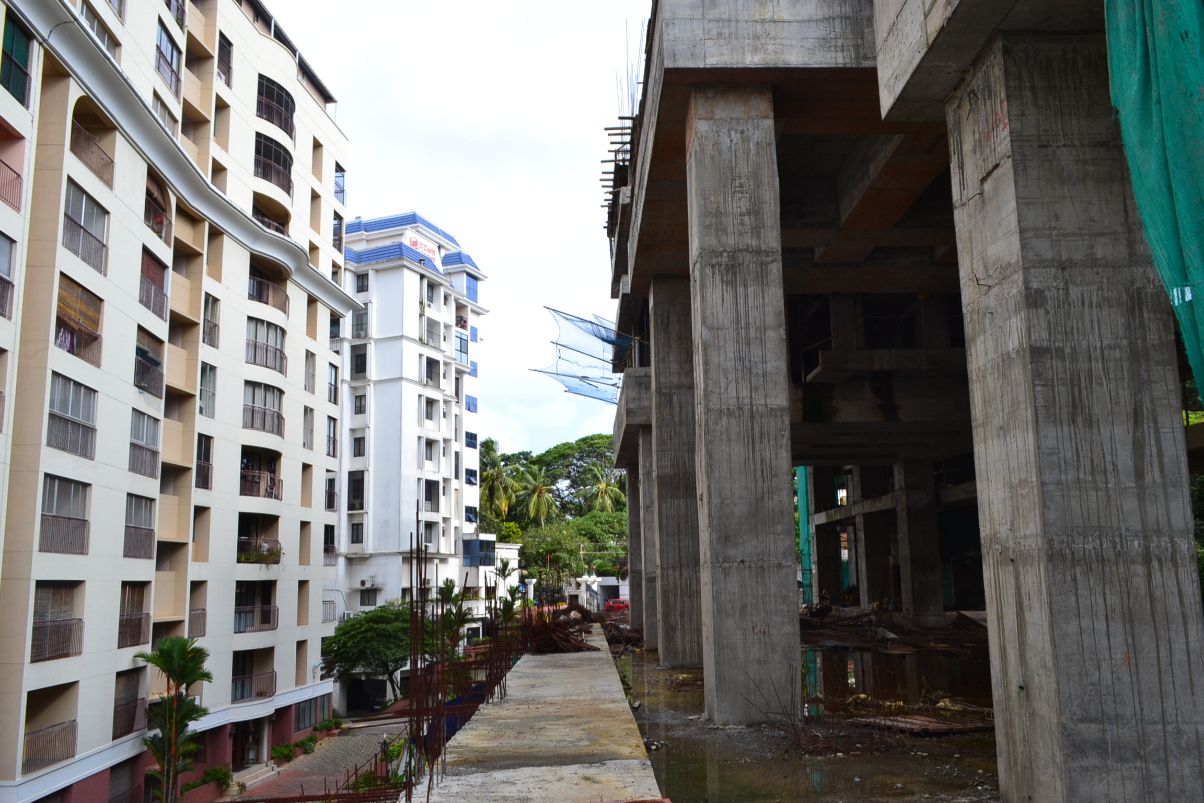

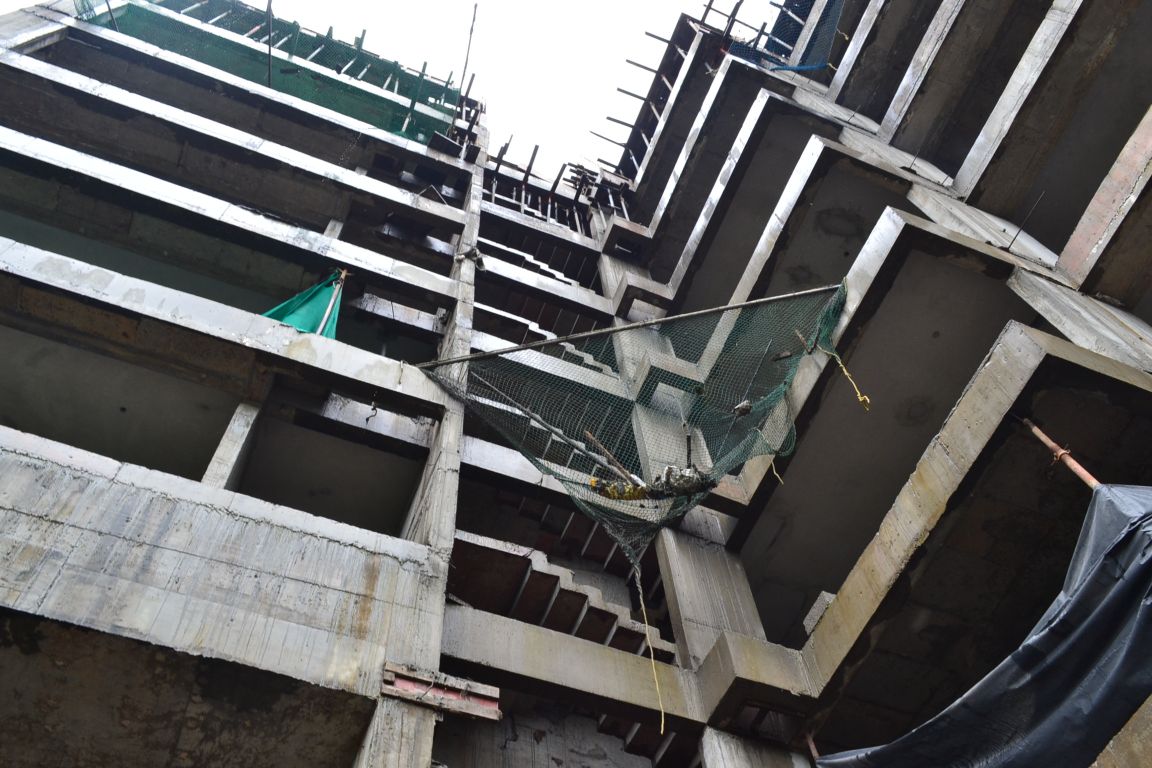

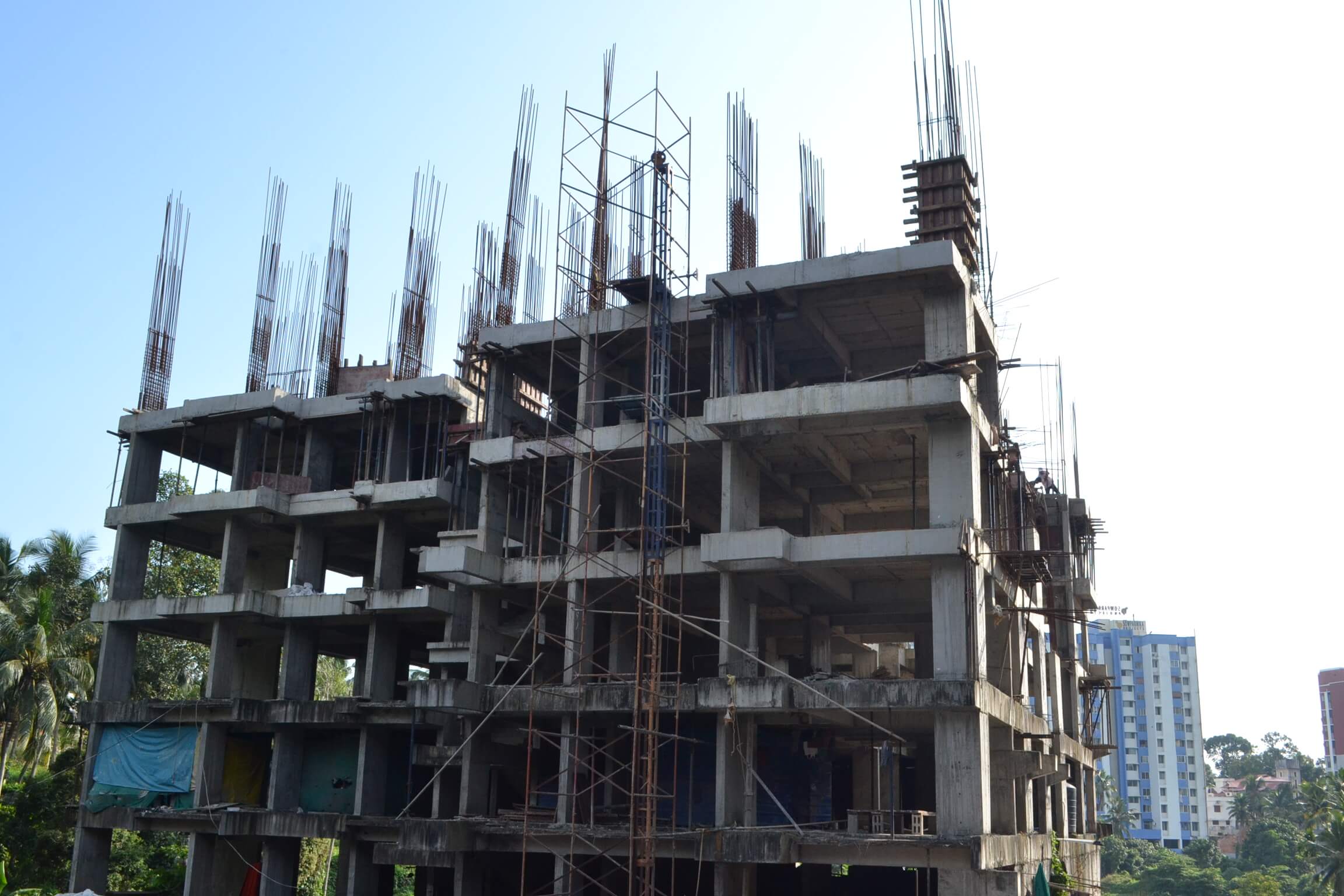

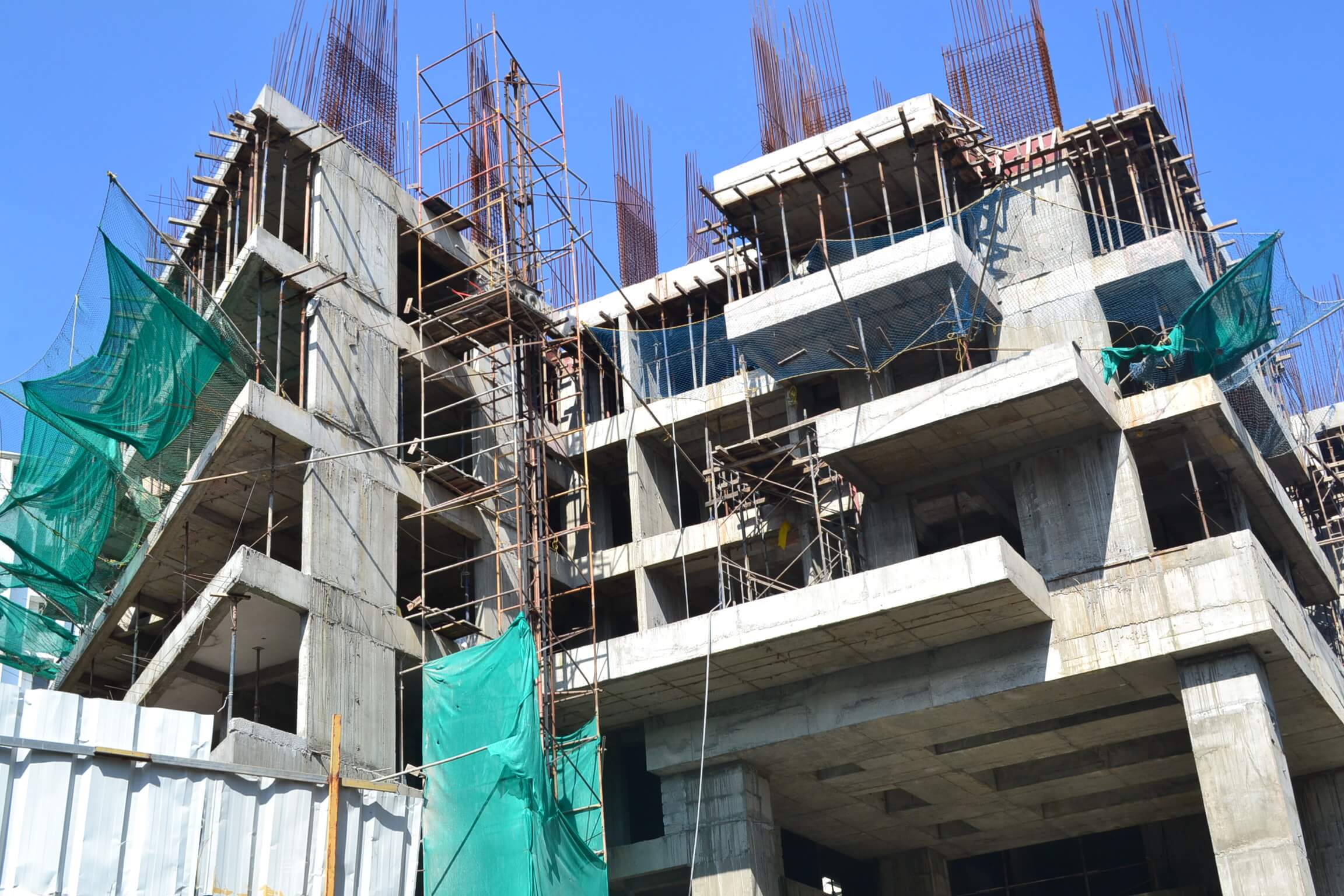

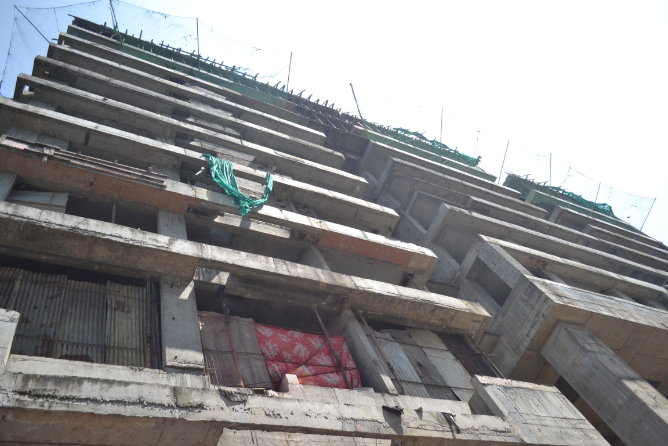

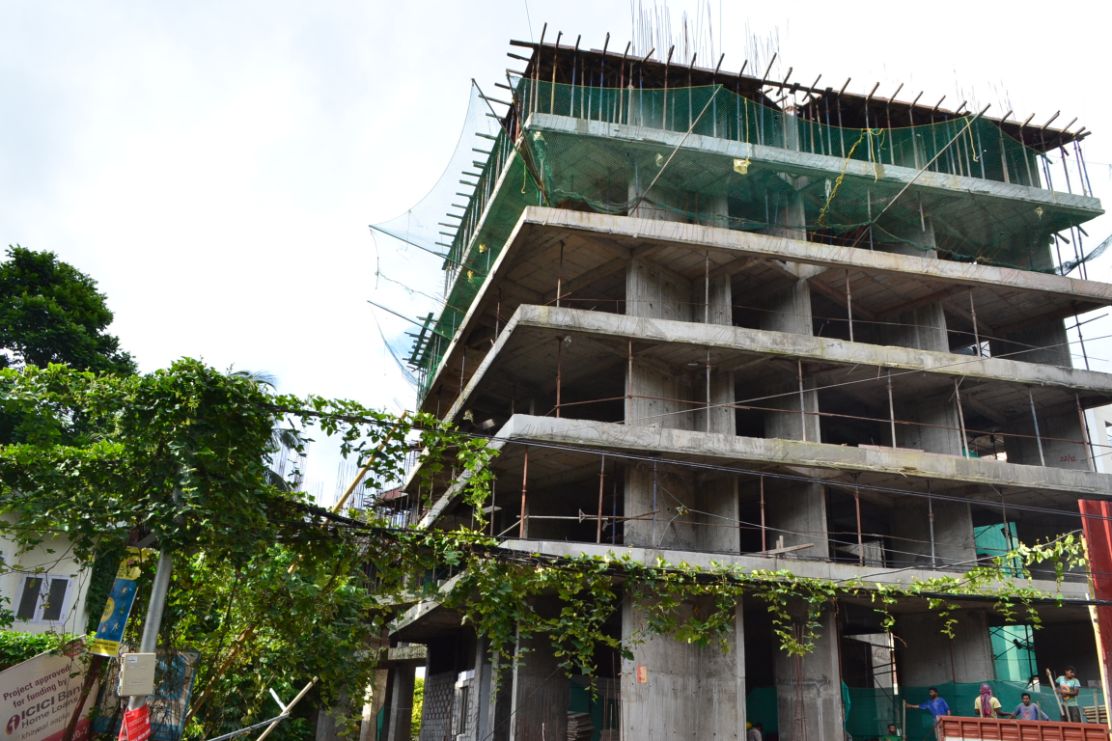

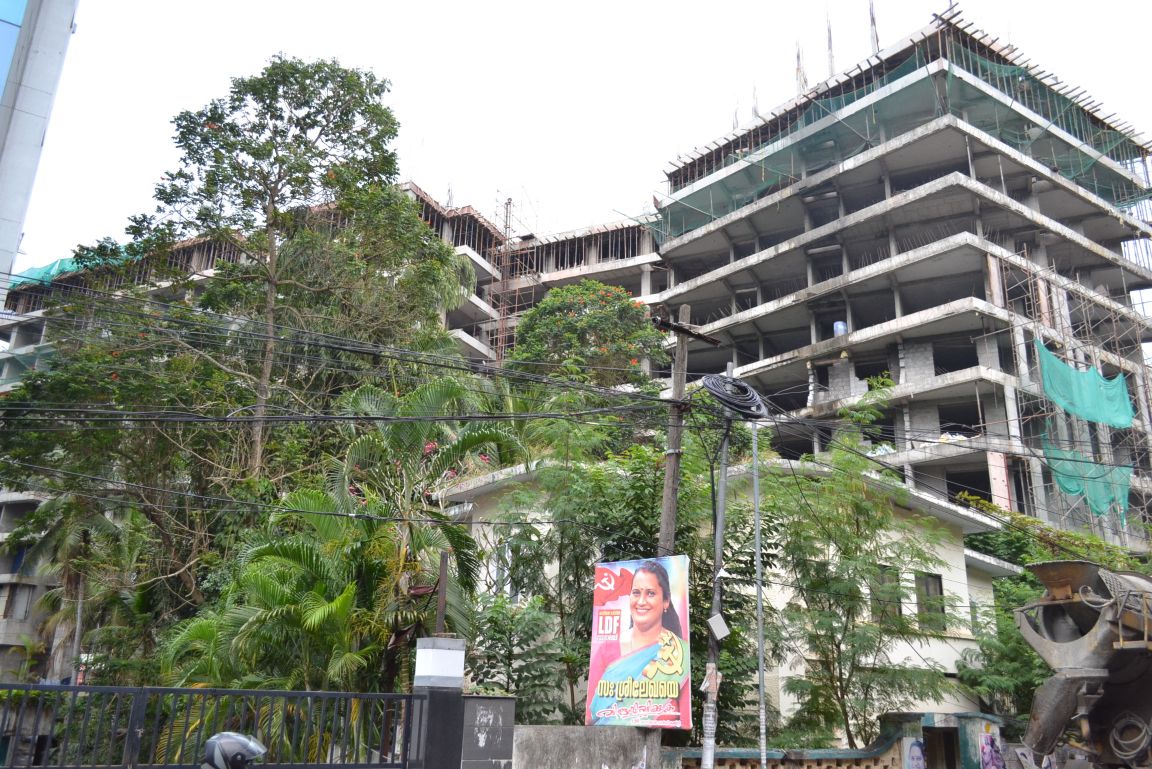

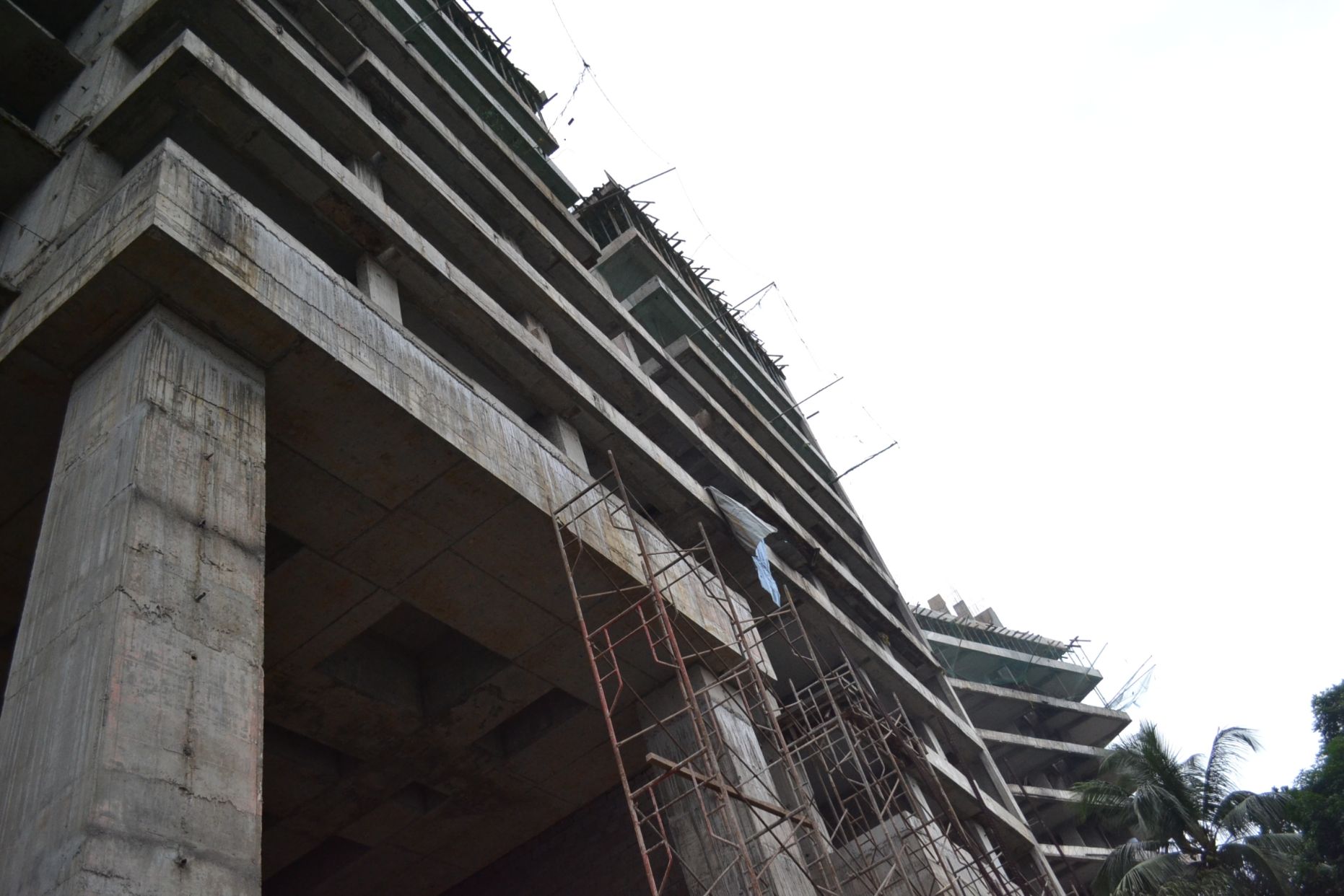

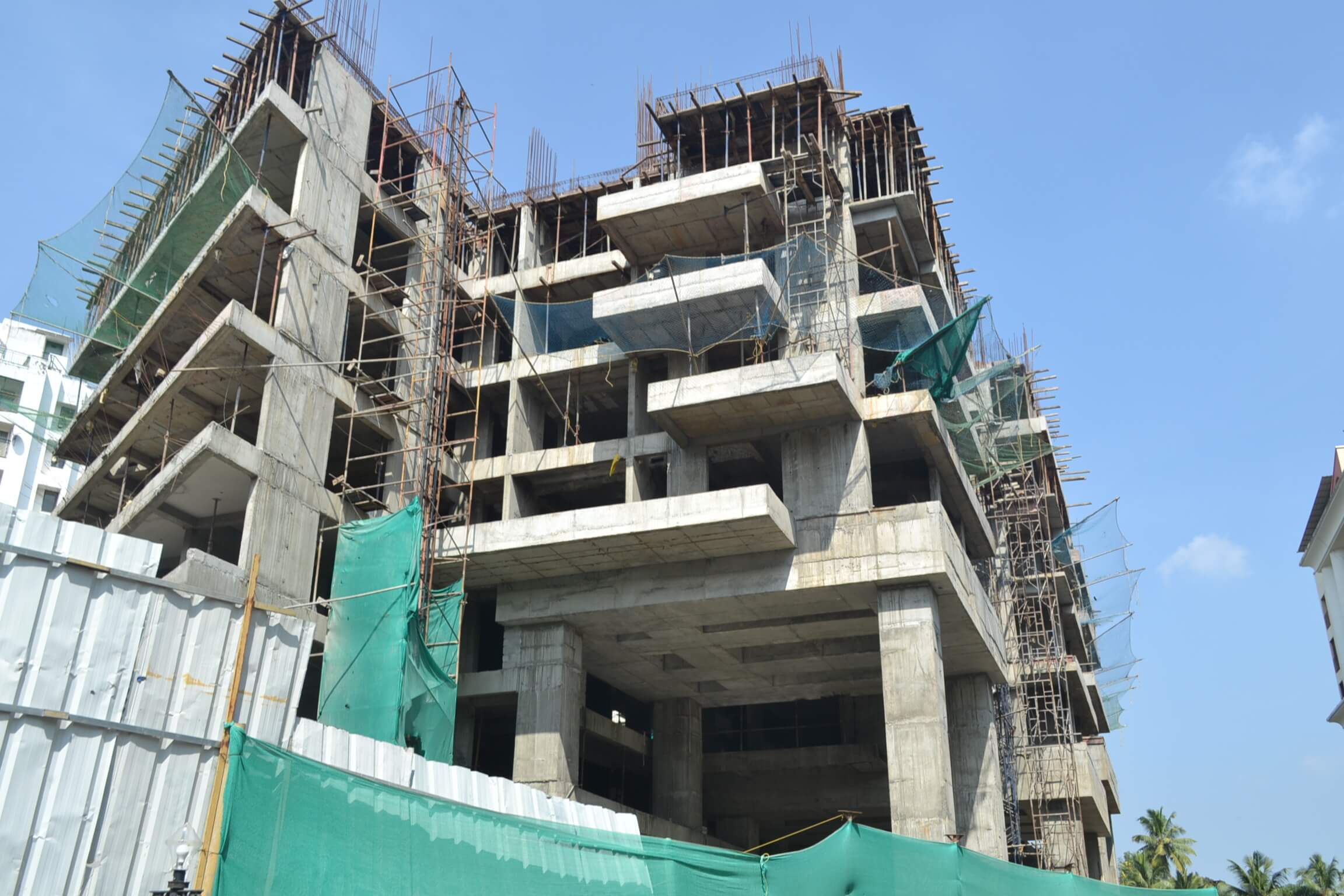

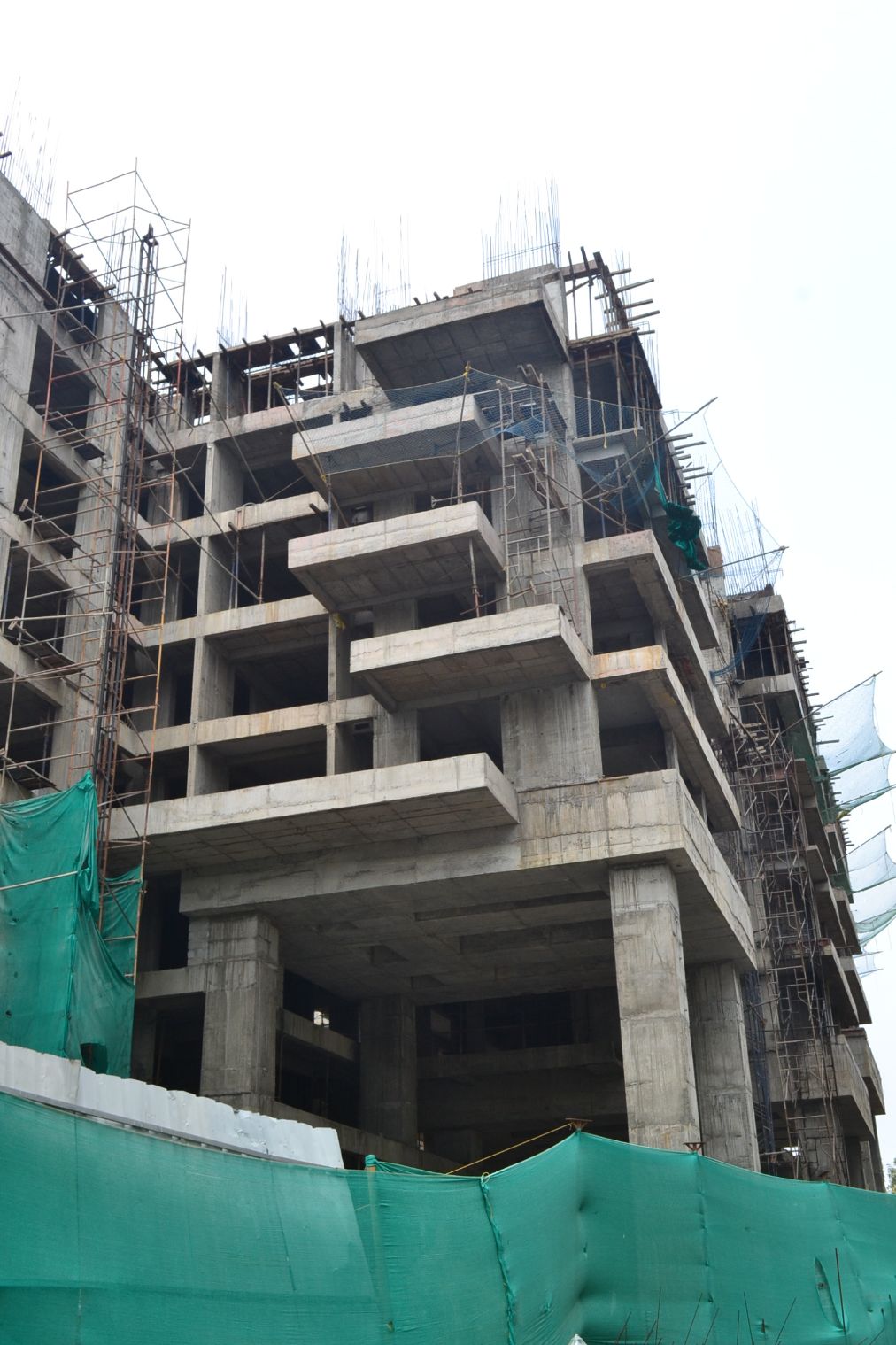

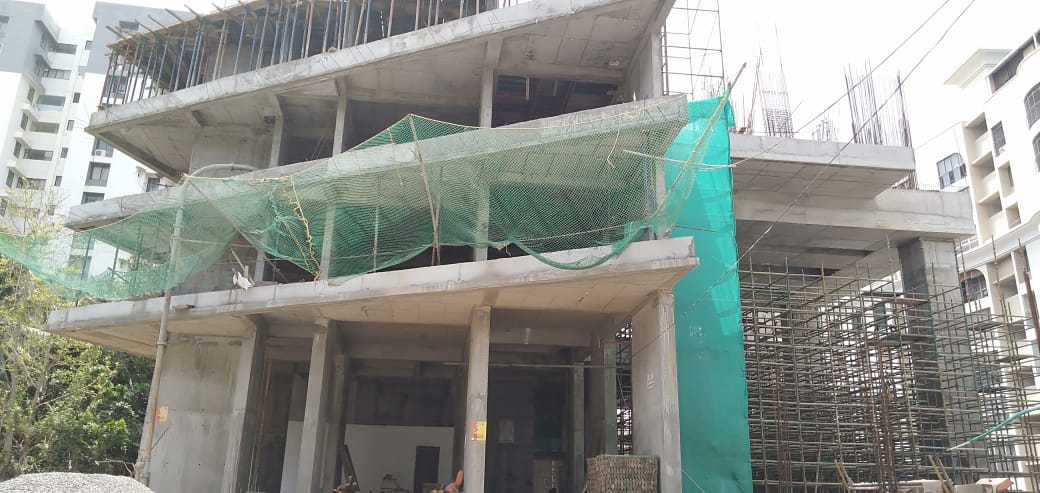

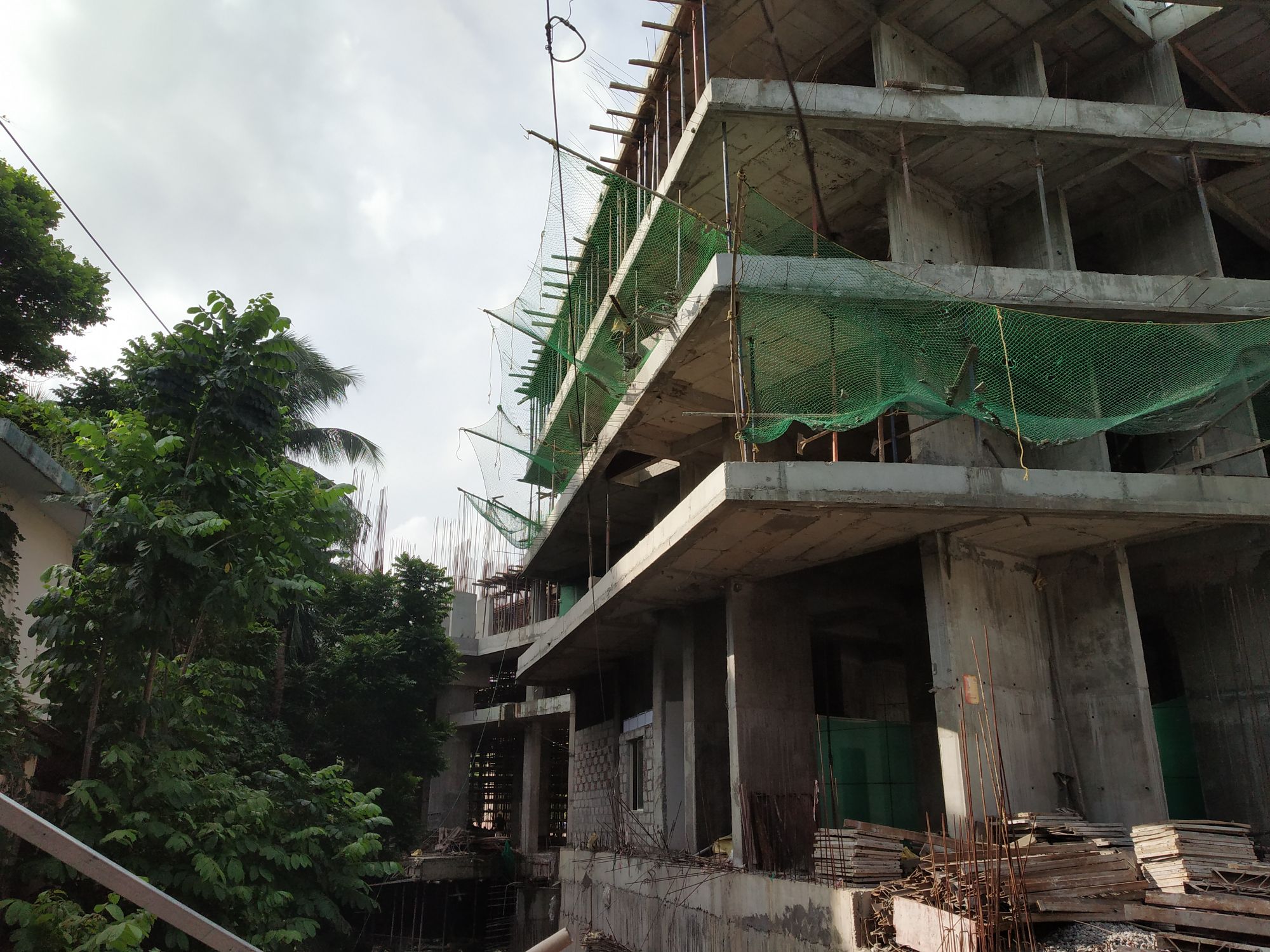

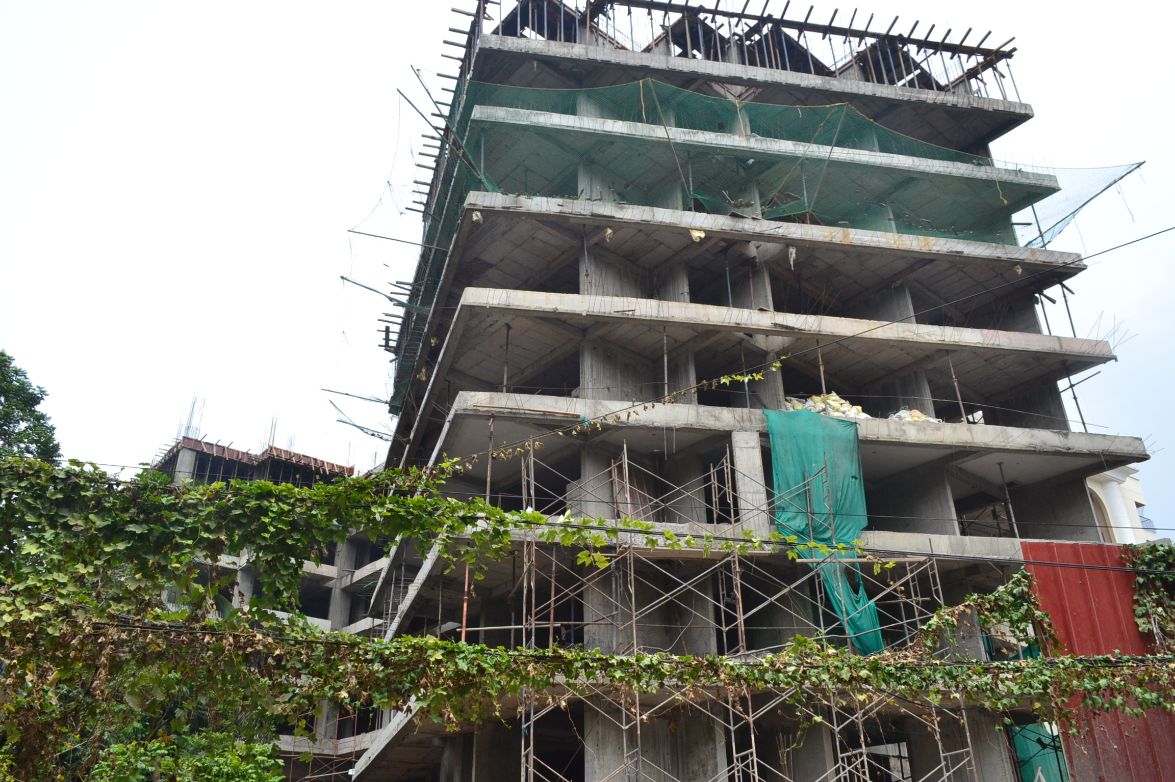

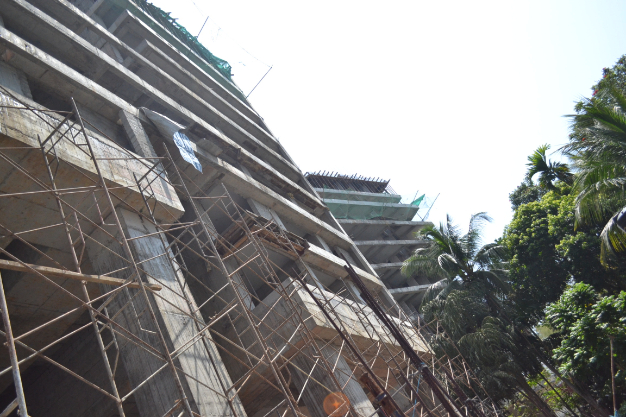

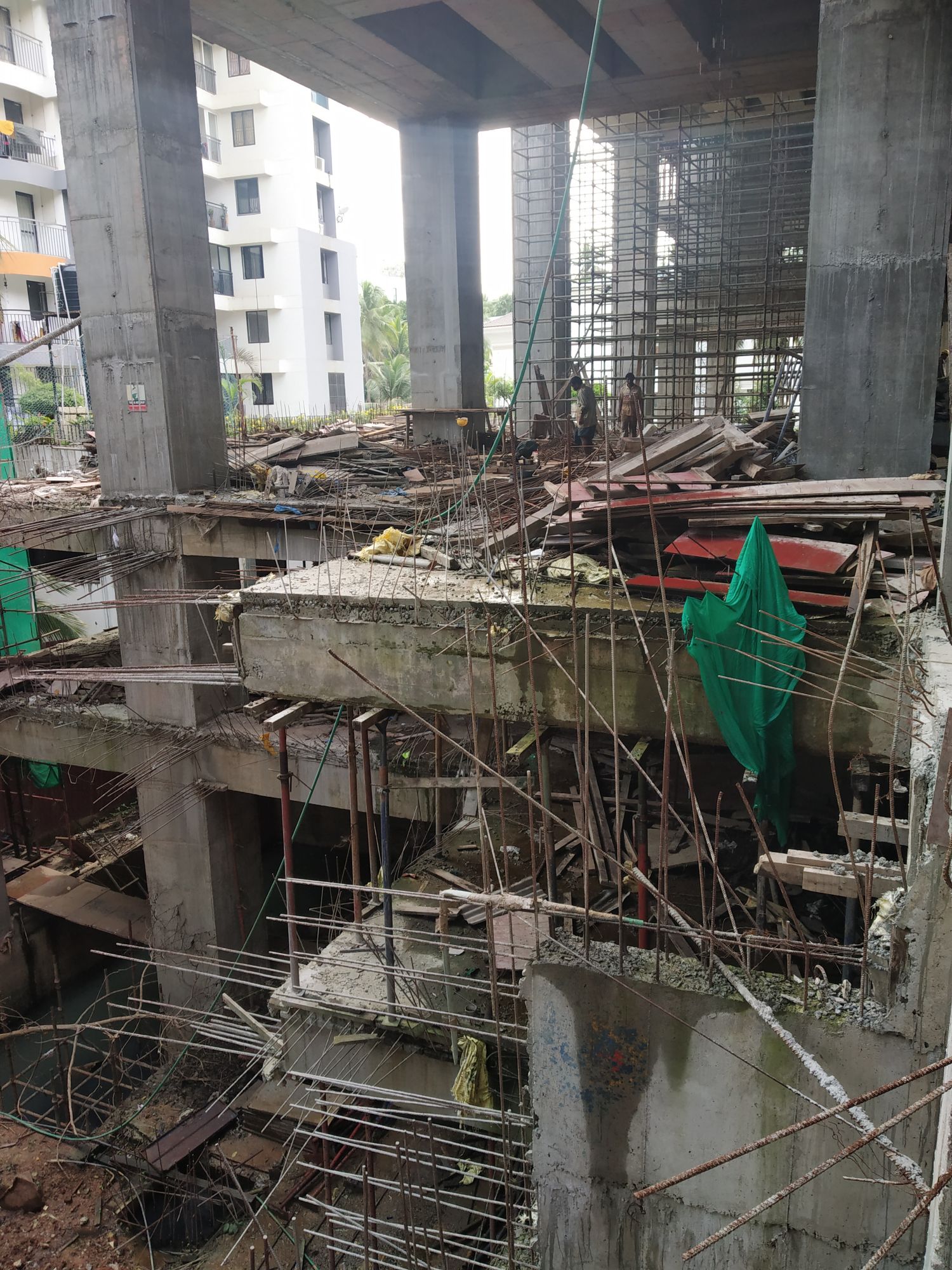

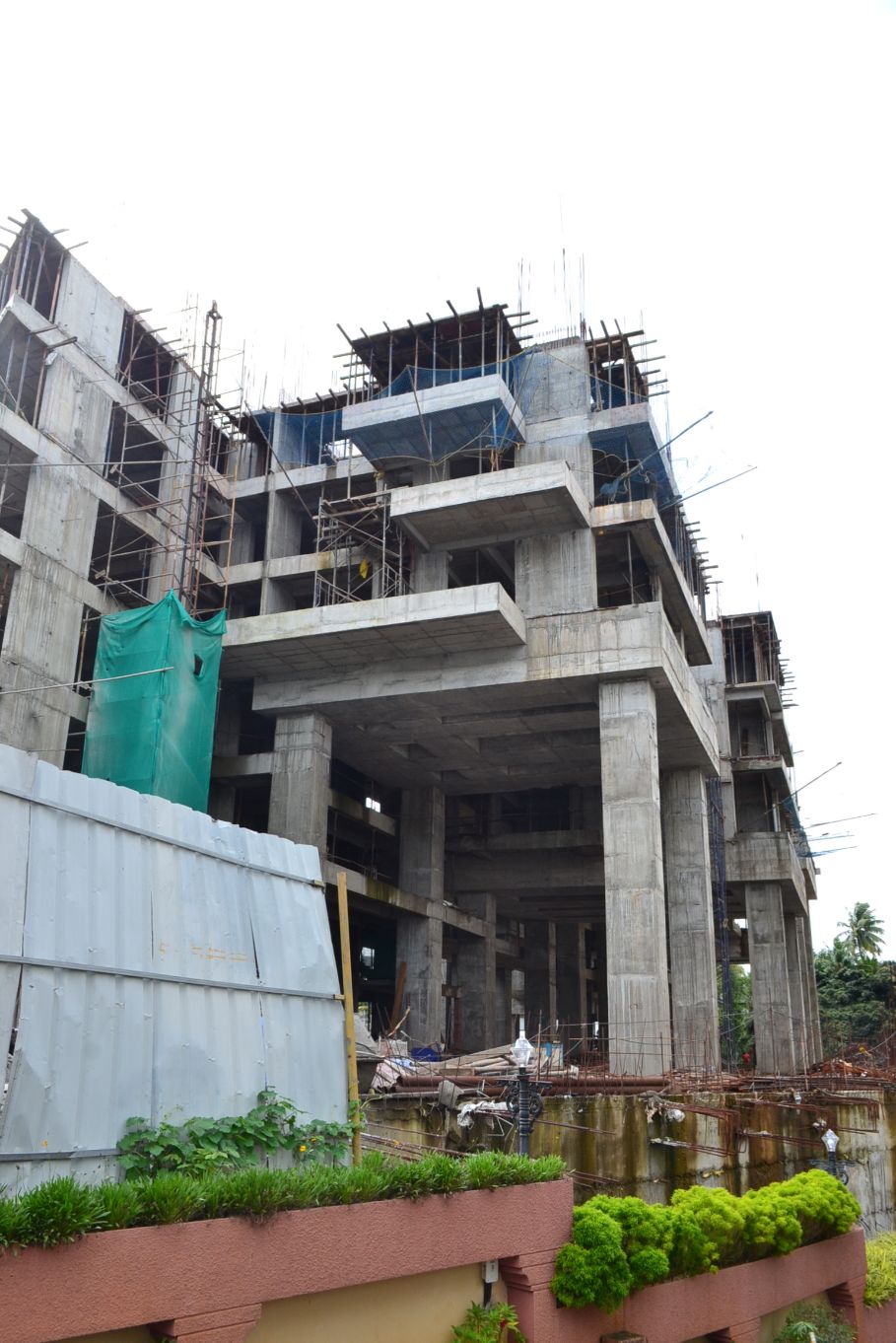

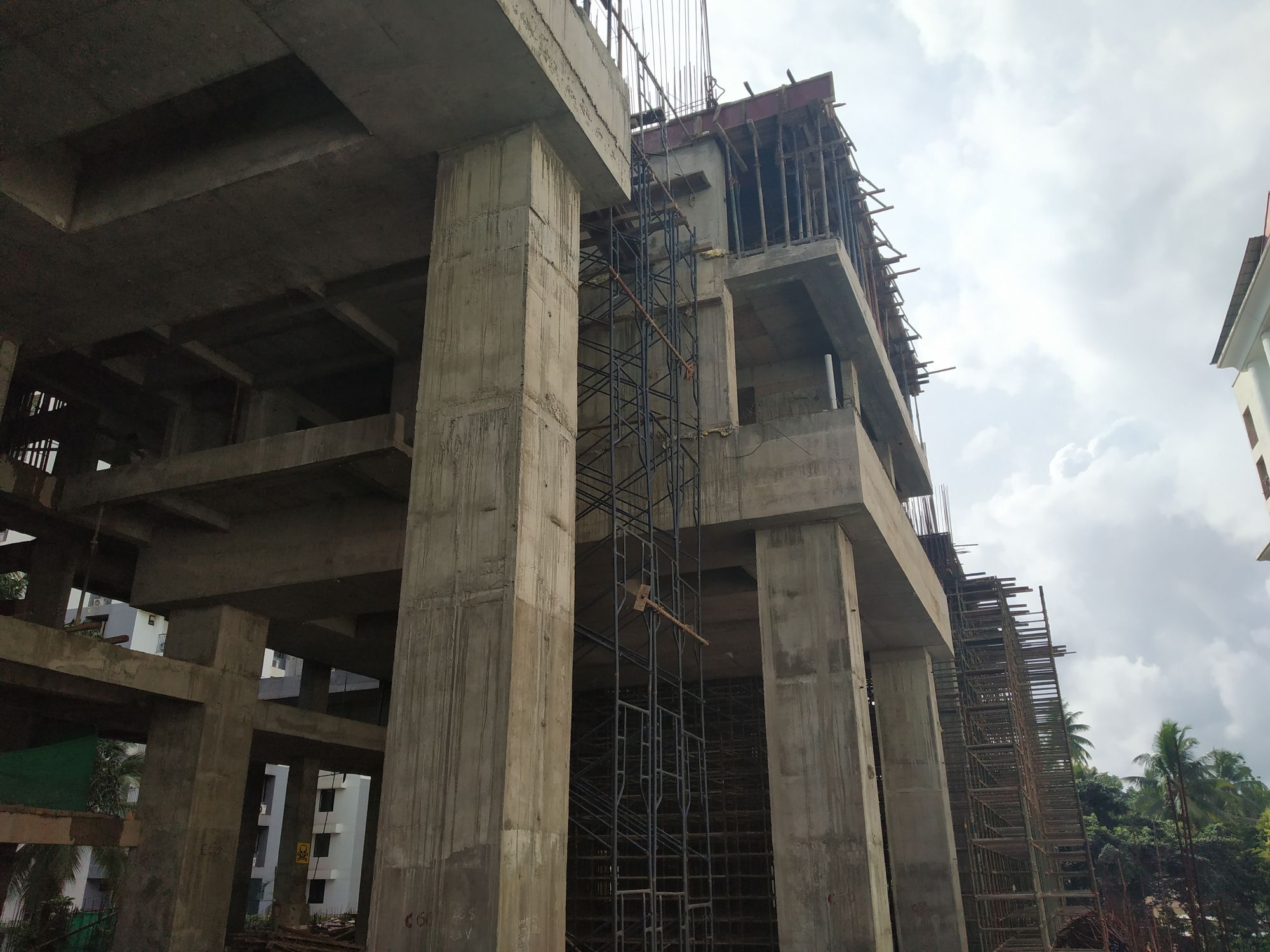

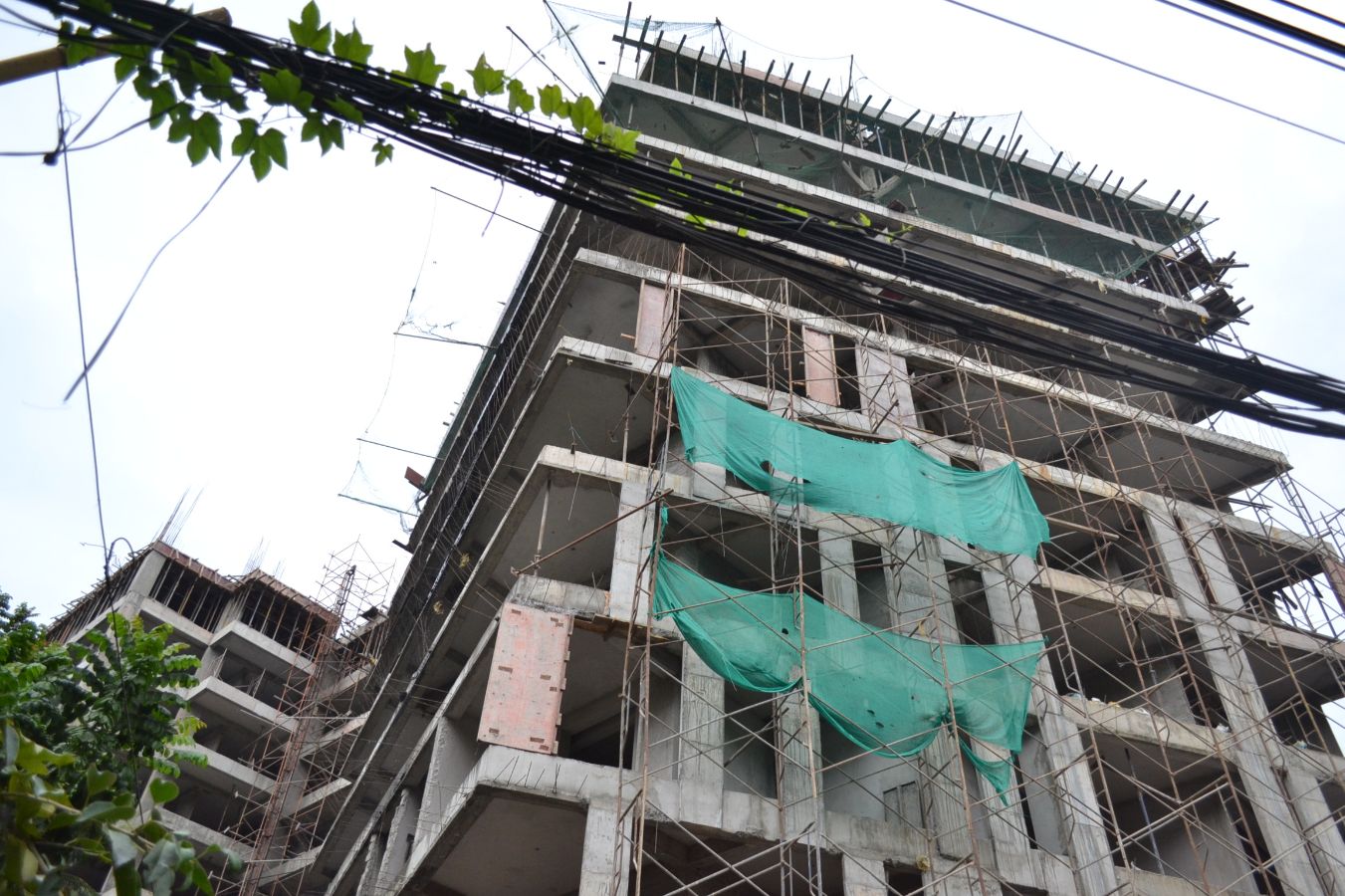

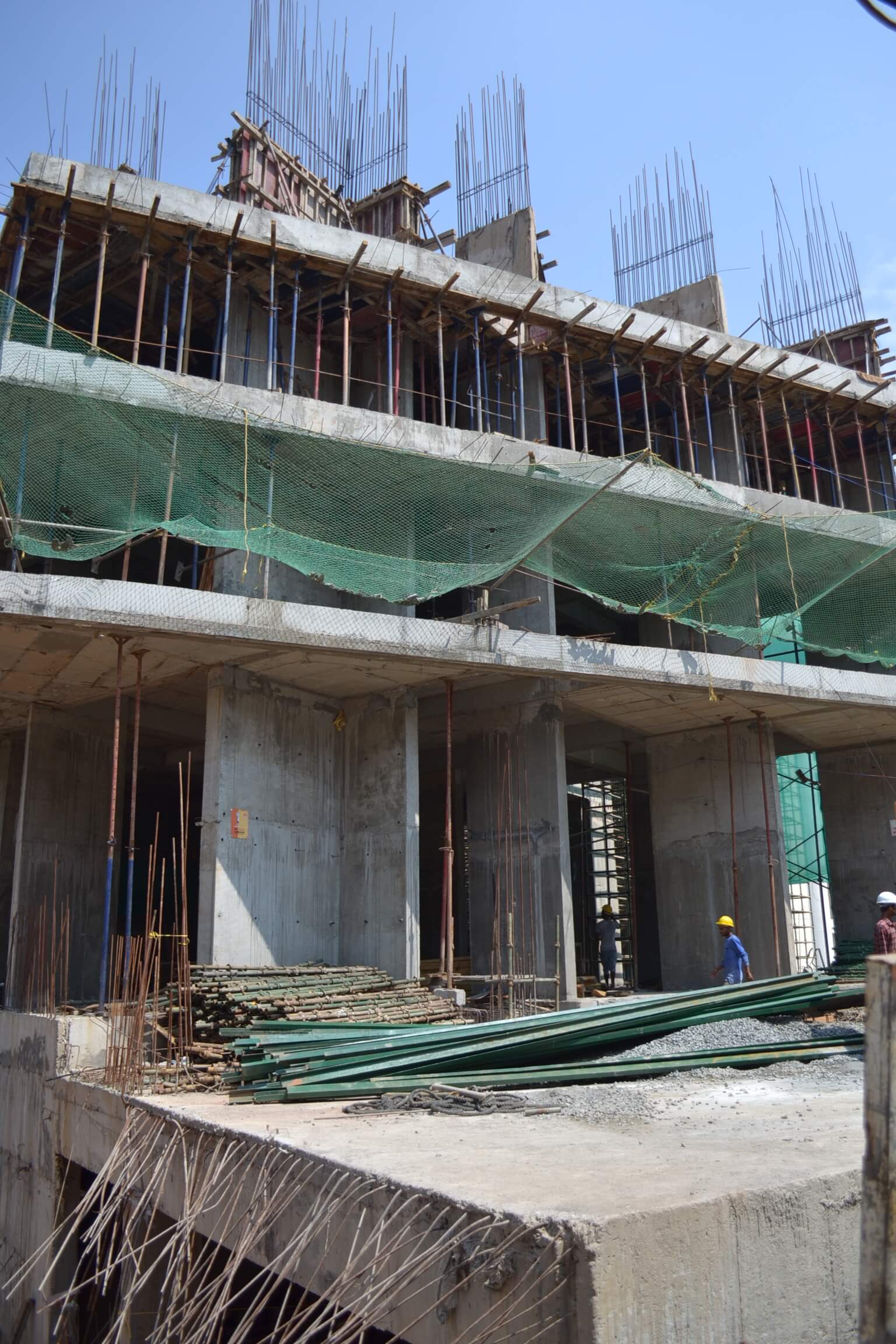

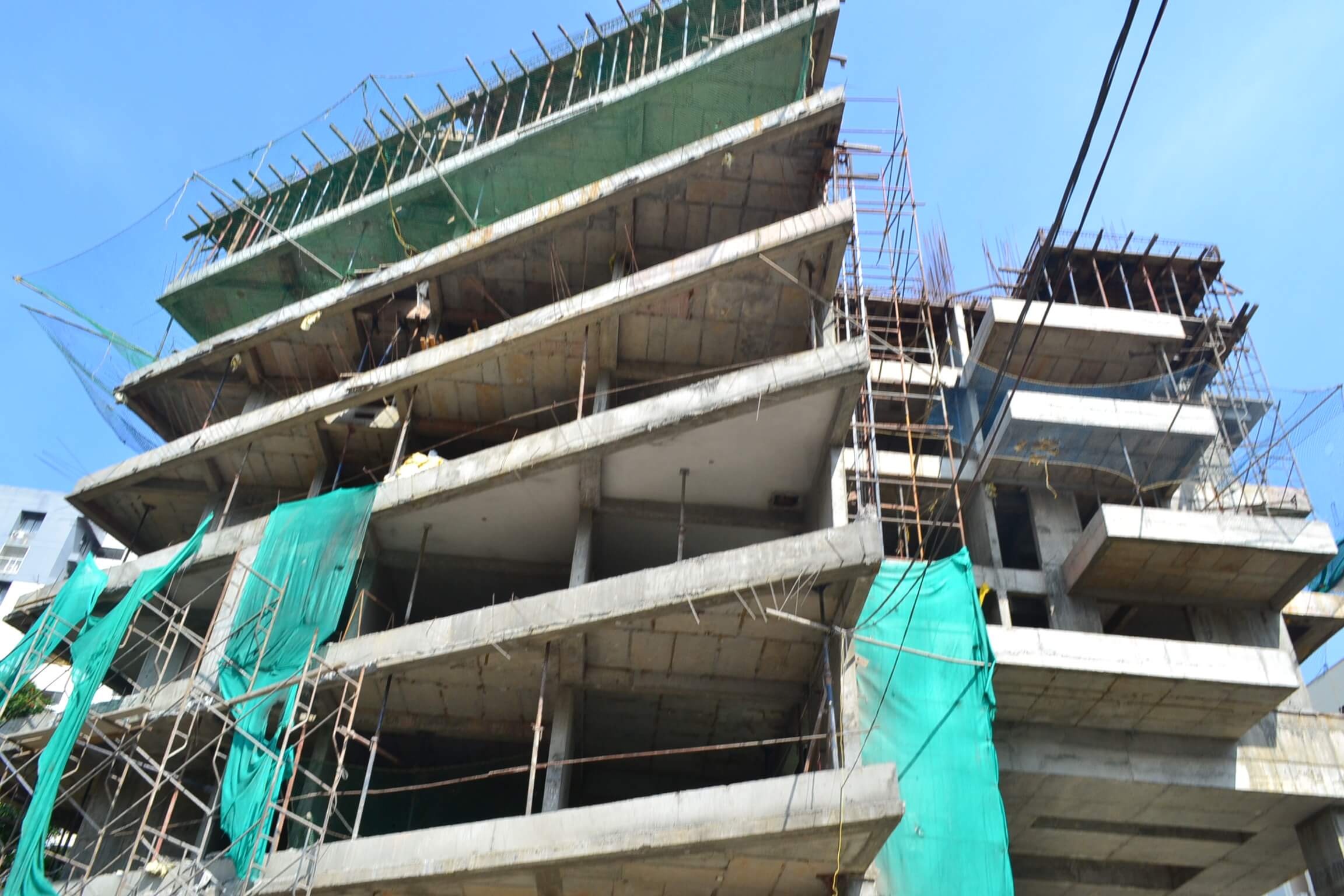

            • RCC for slab – BF2 slab – 100%completed.

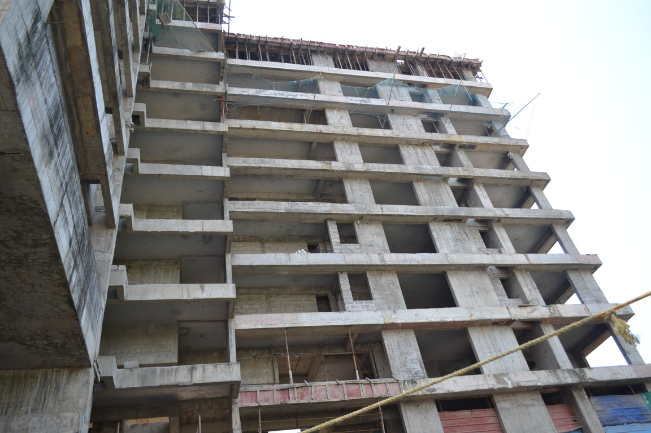

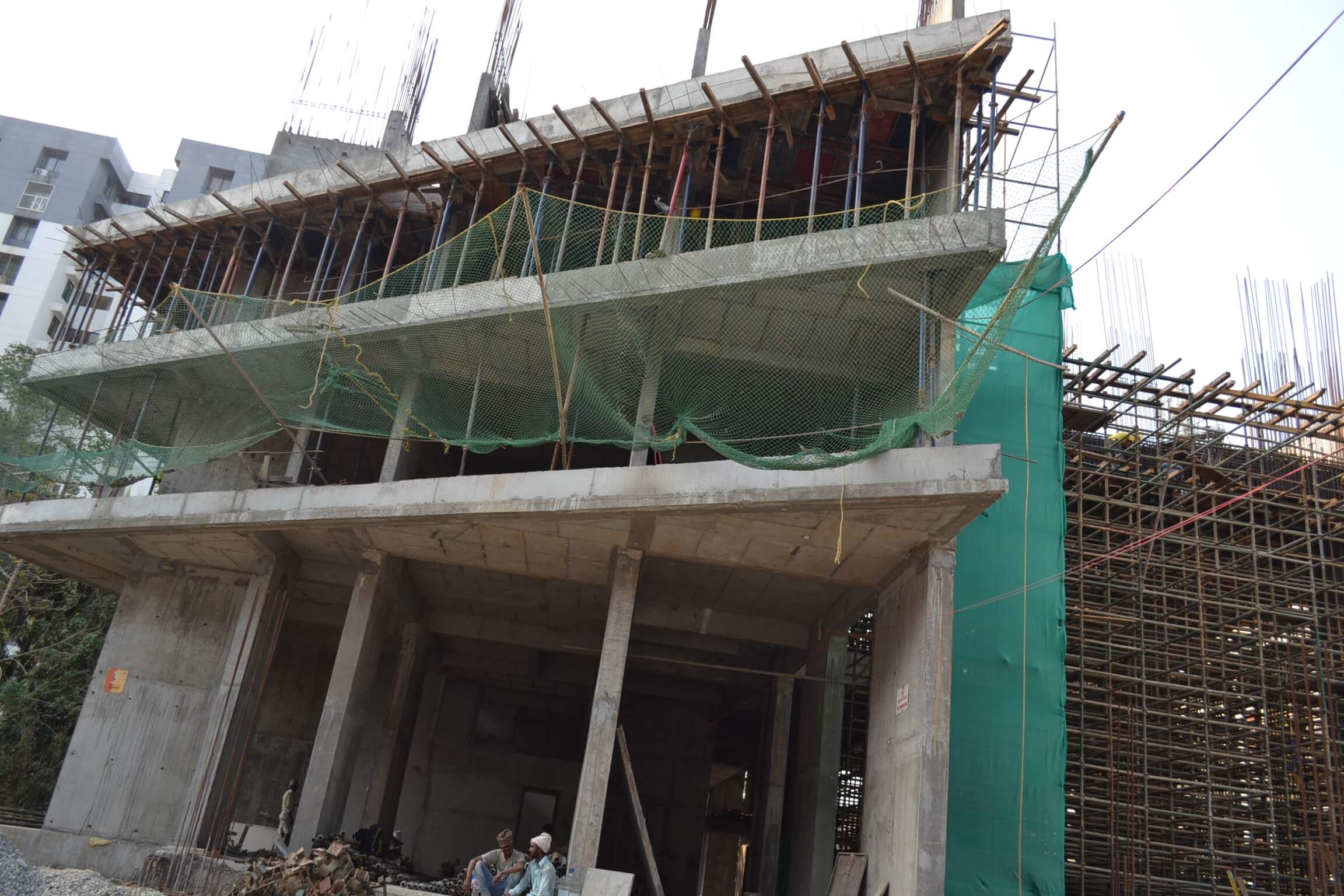

            • BF1 slab -RCC work 100% completed

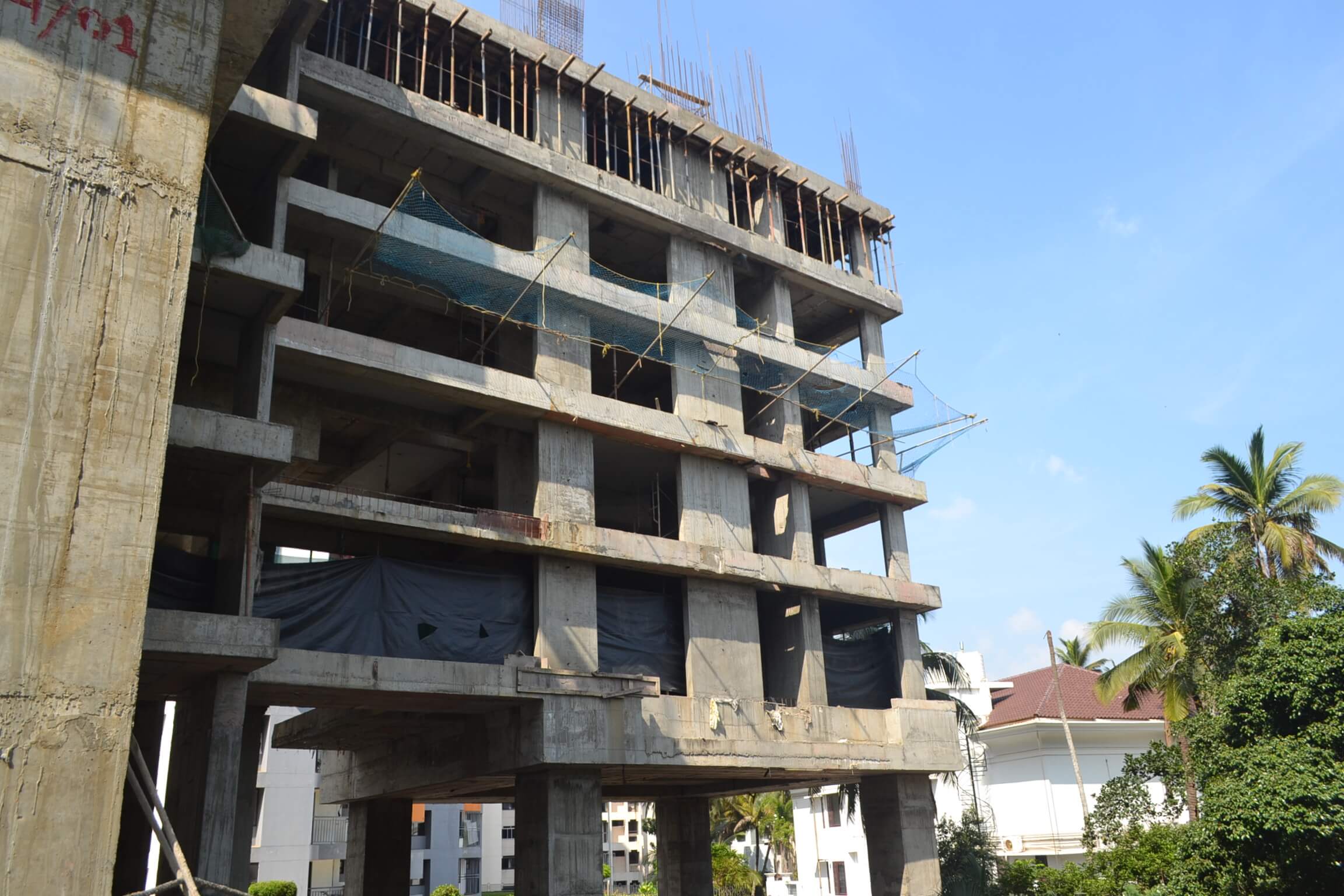

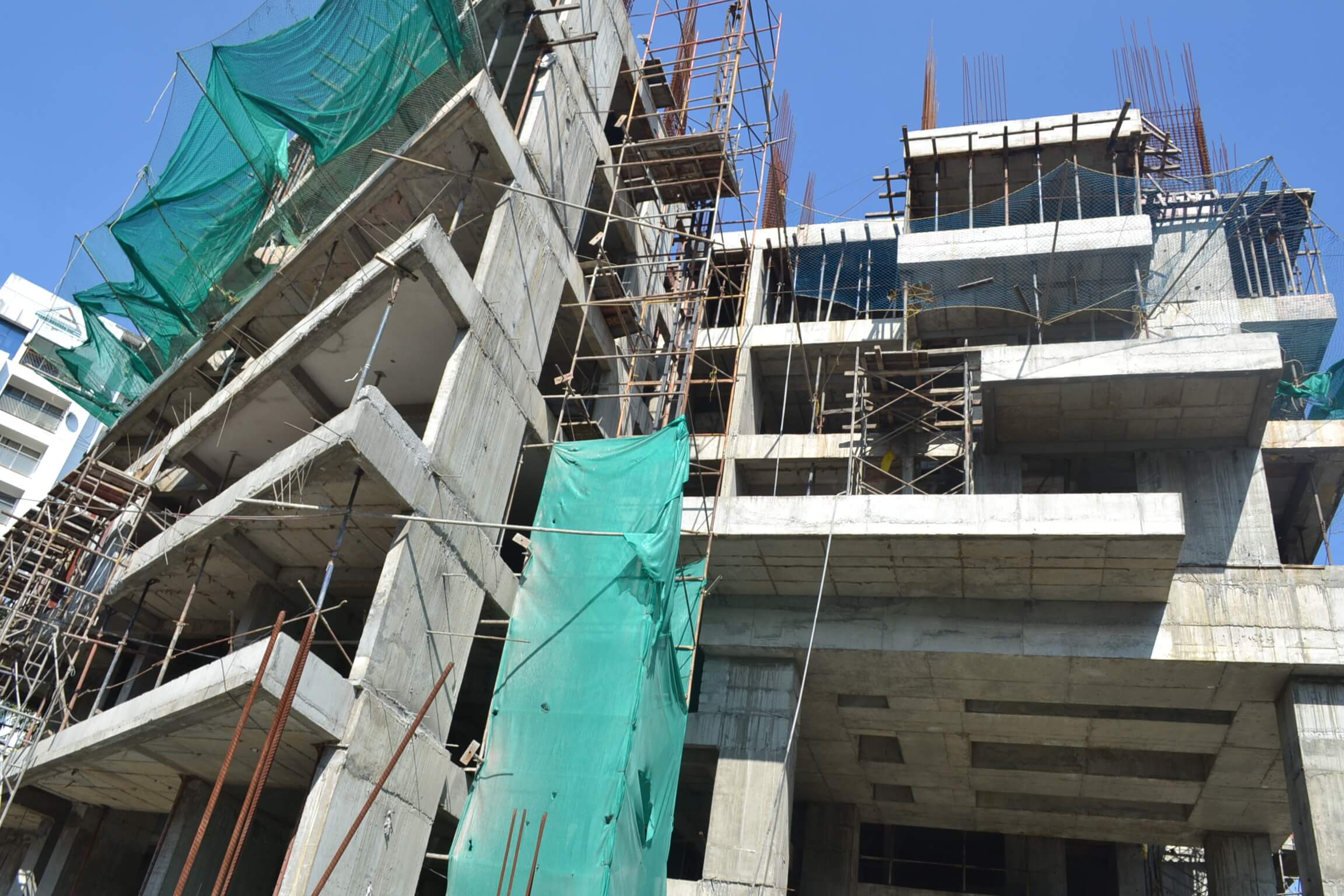

            • Ground floor slabs -RCC Work100%completed.

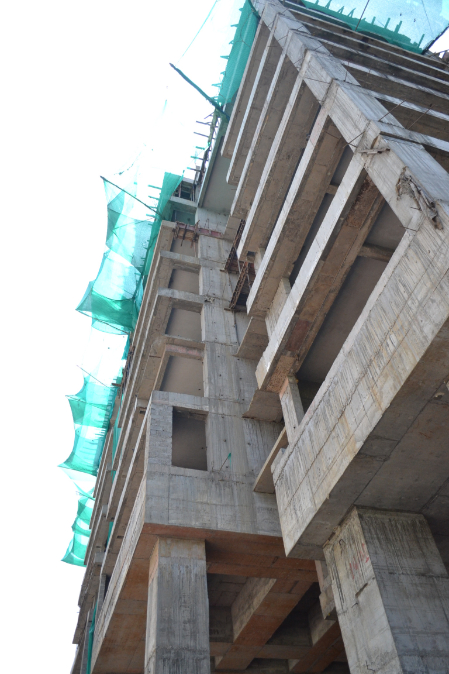

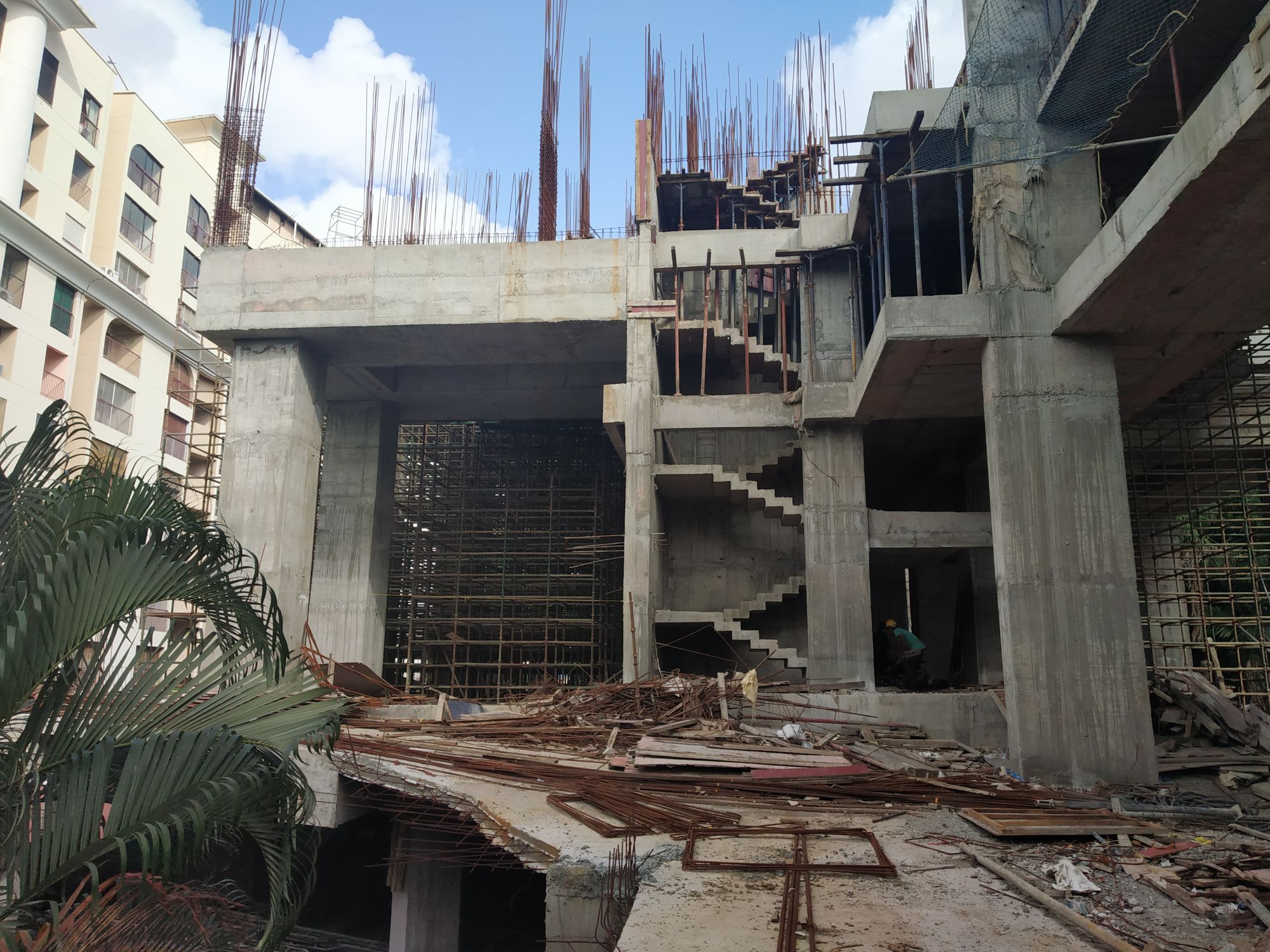

            • First floor slab -100%completed

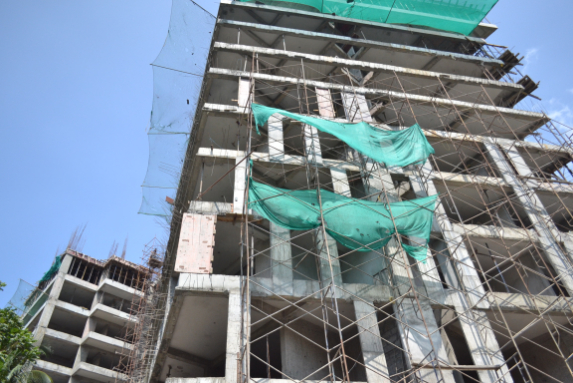

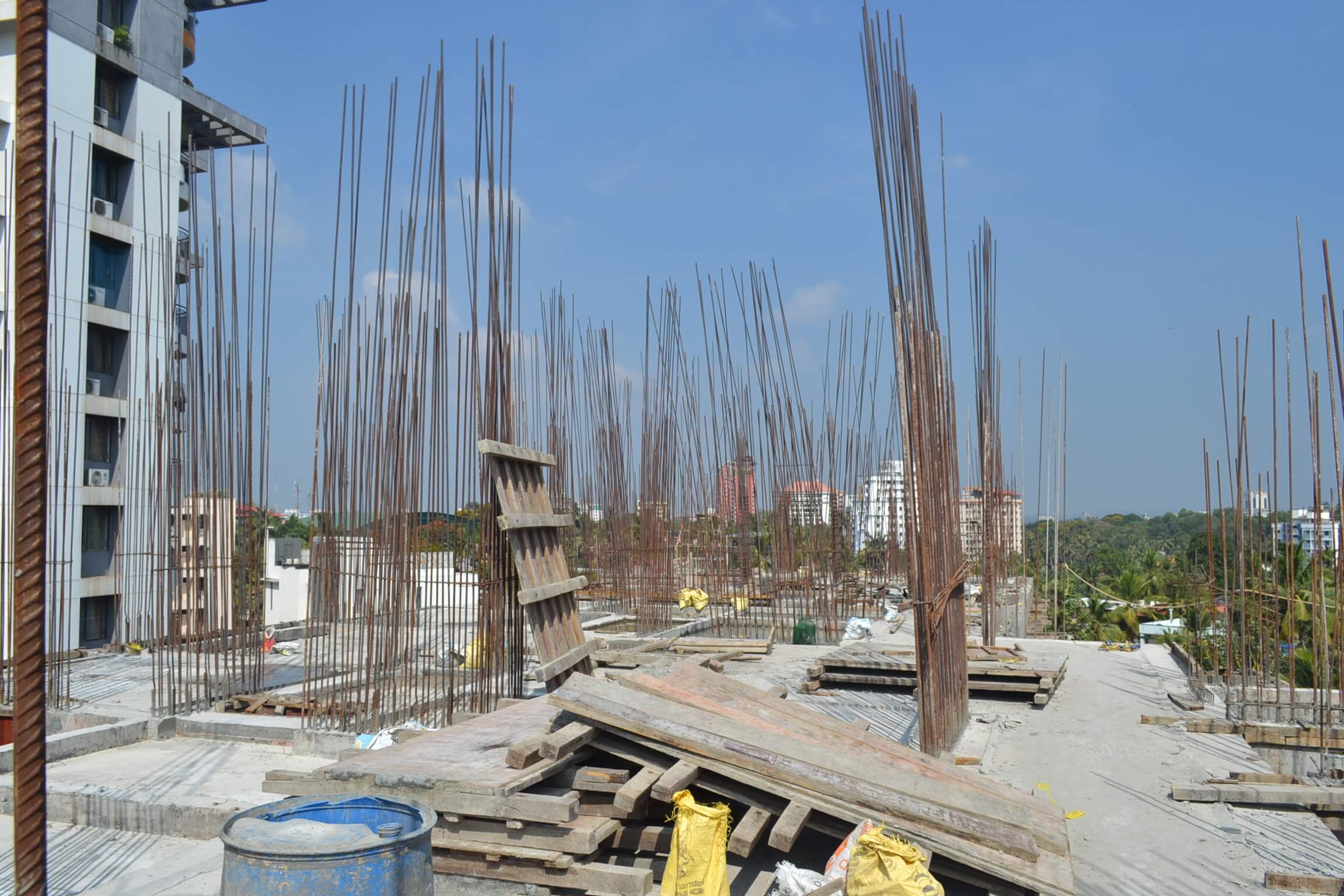

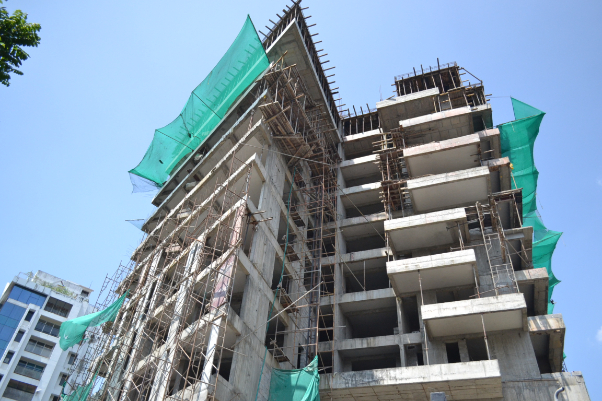

            • Second floor slab -90% completed

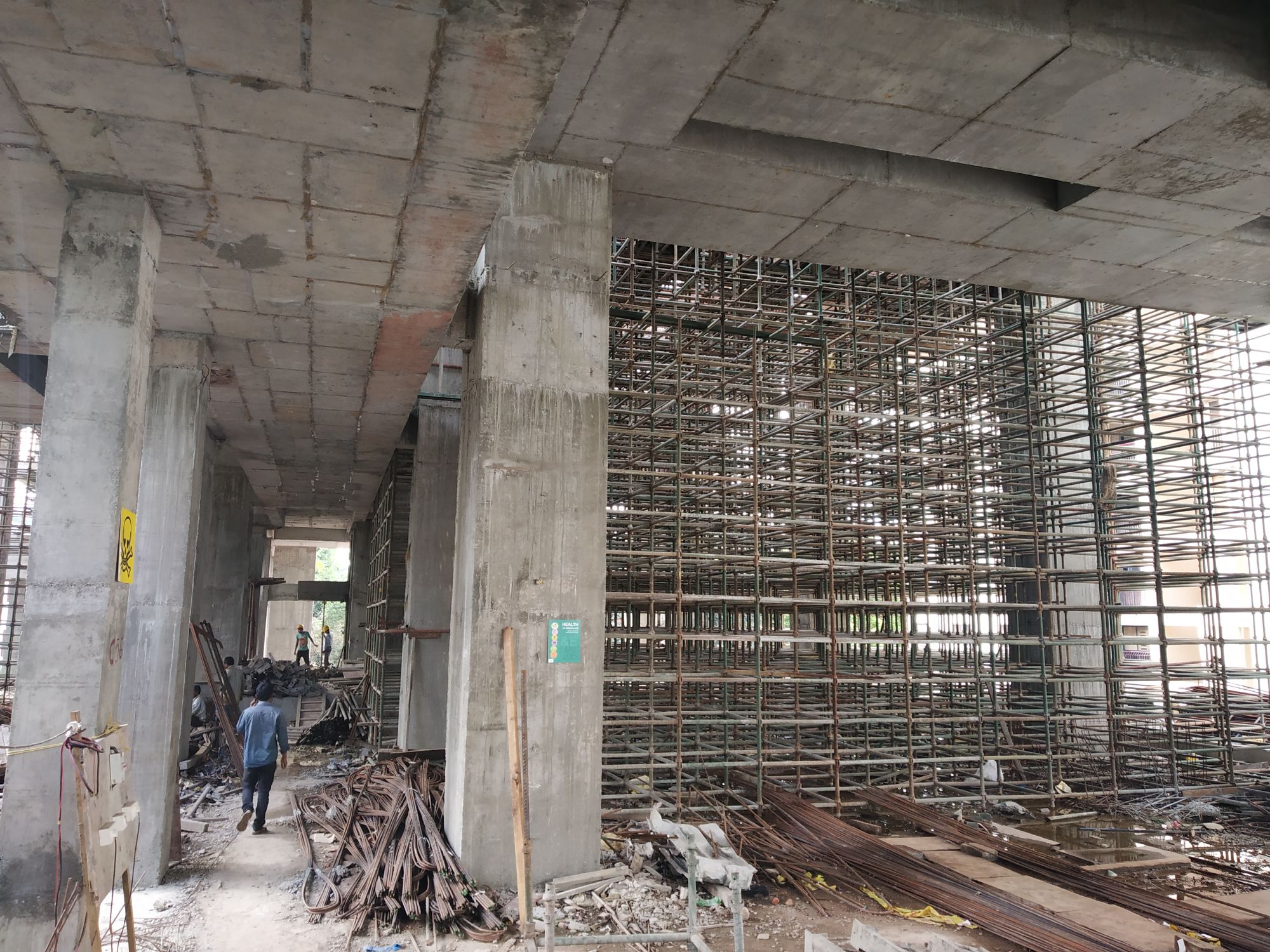

            • Third floor slab -30% completed

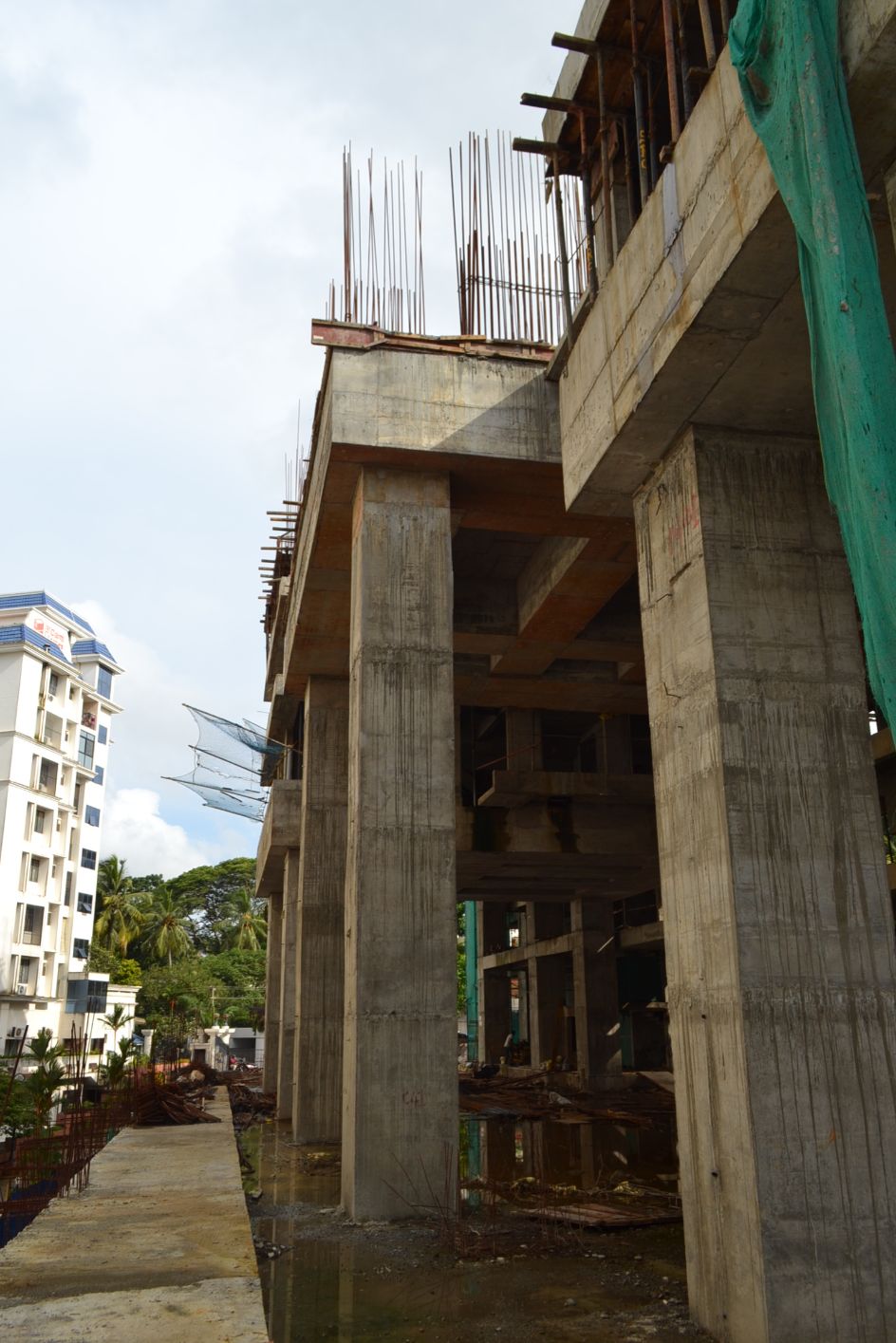

            • BF2- 1st floor Column Rcc work -100% completed

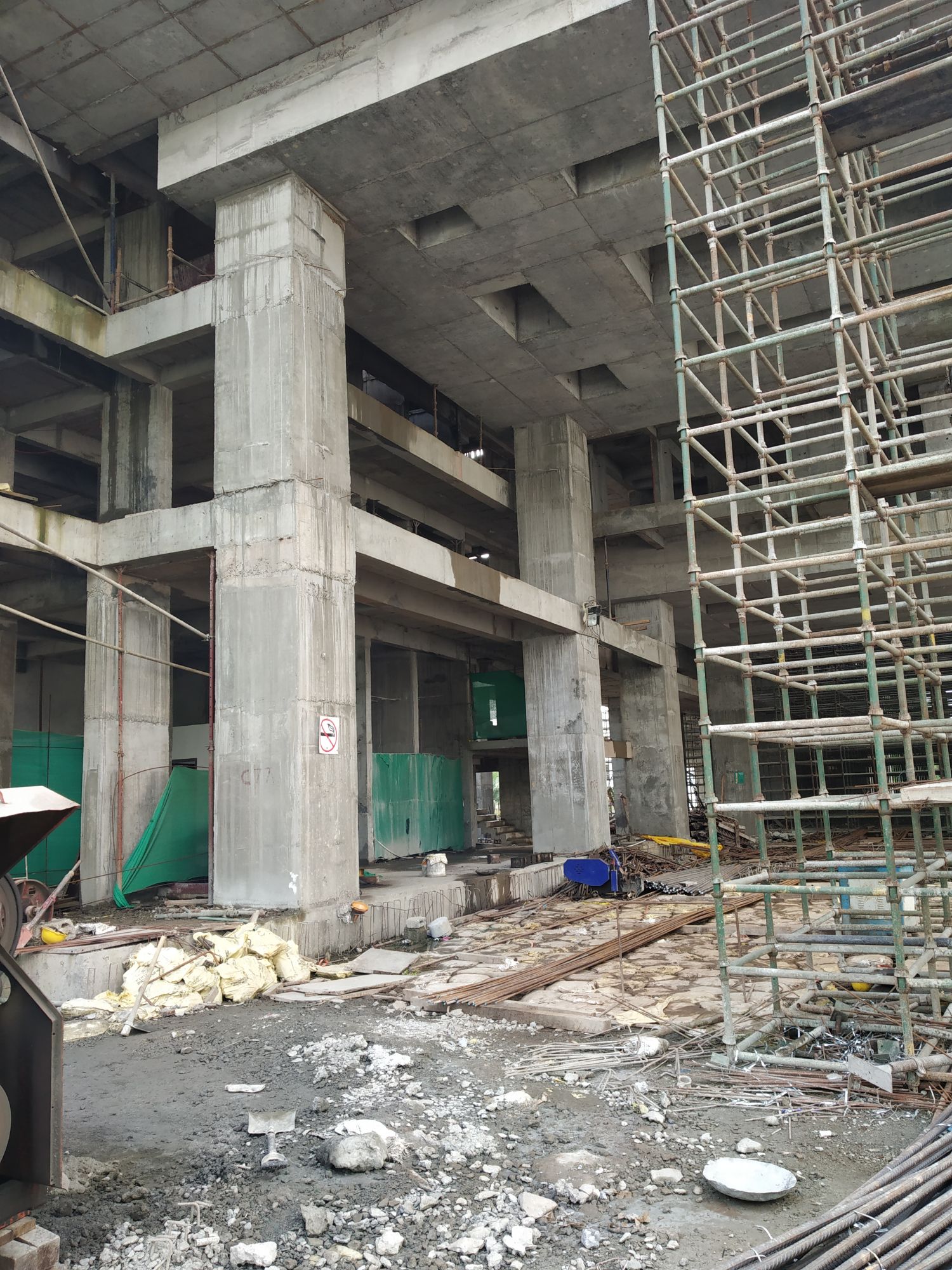

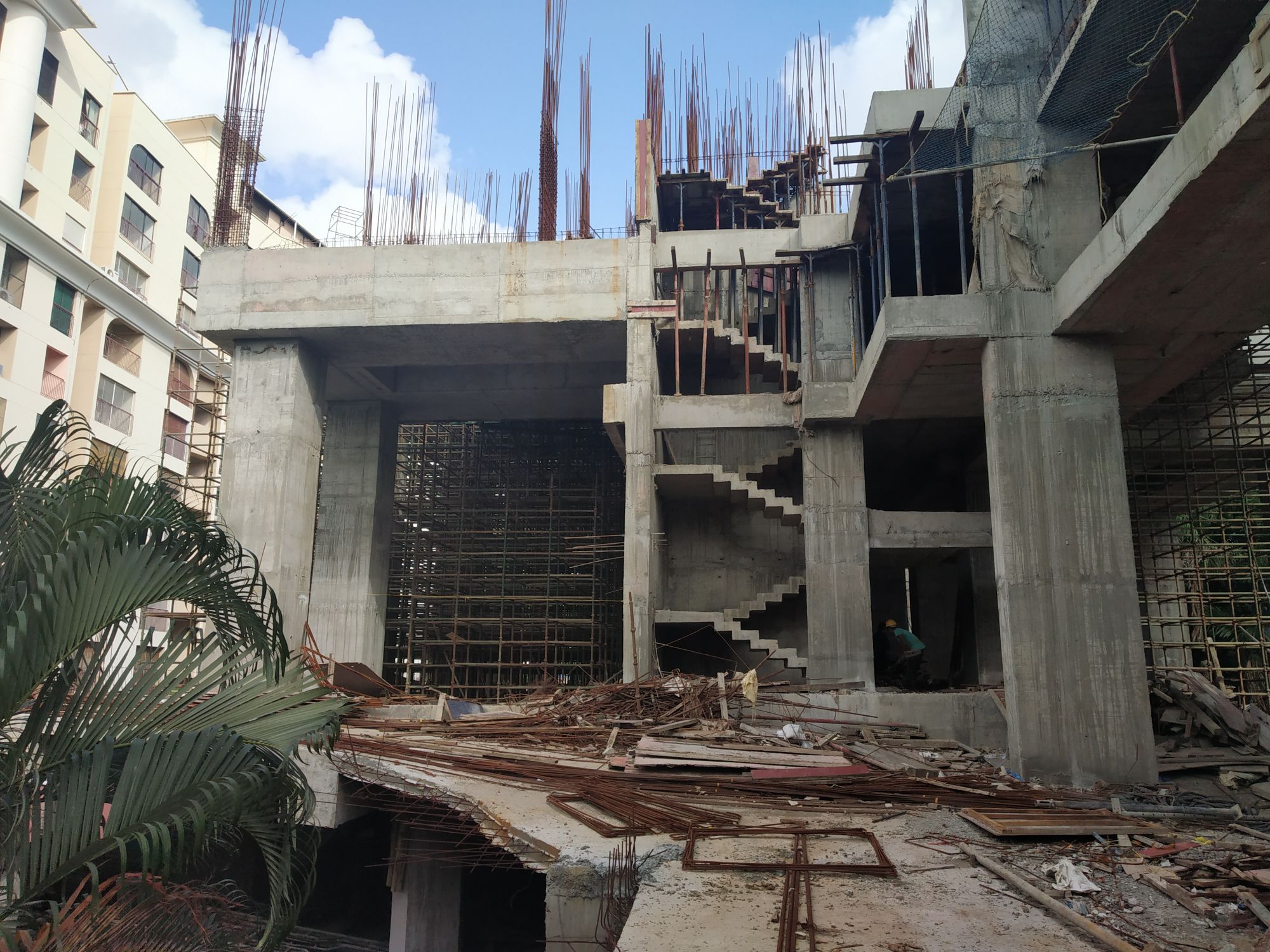

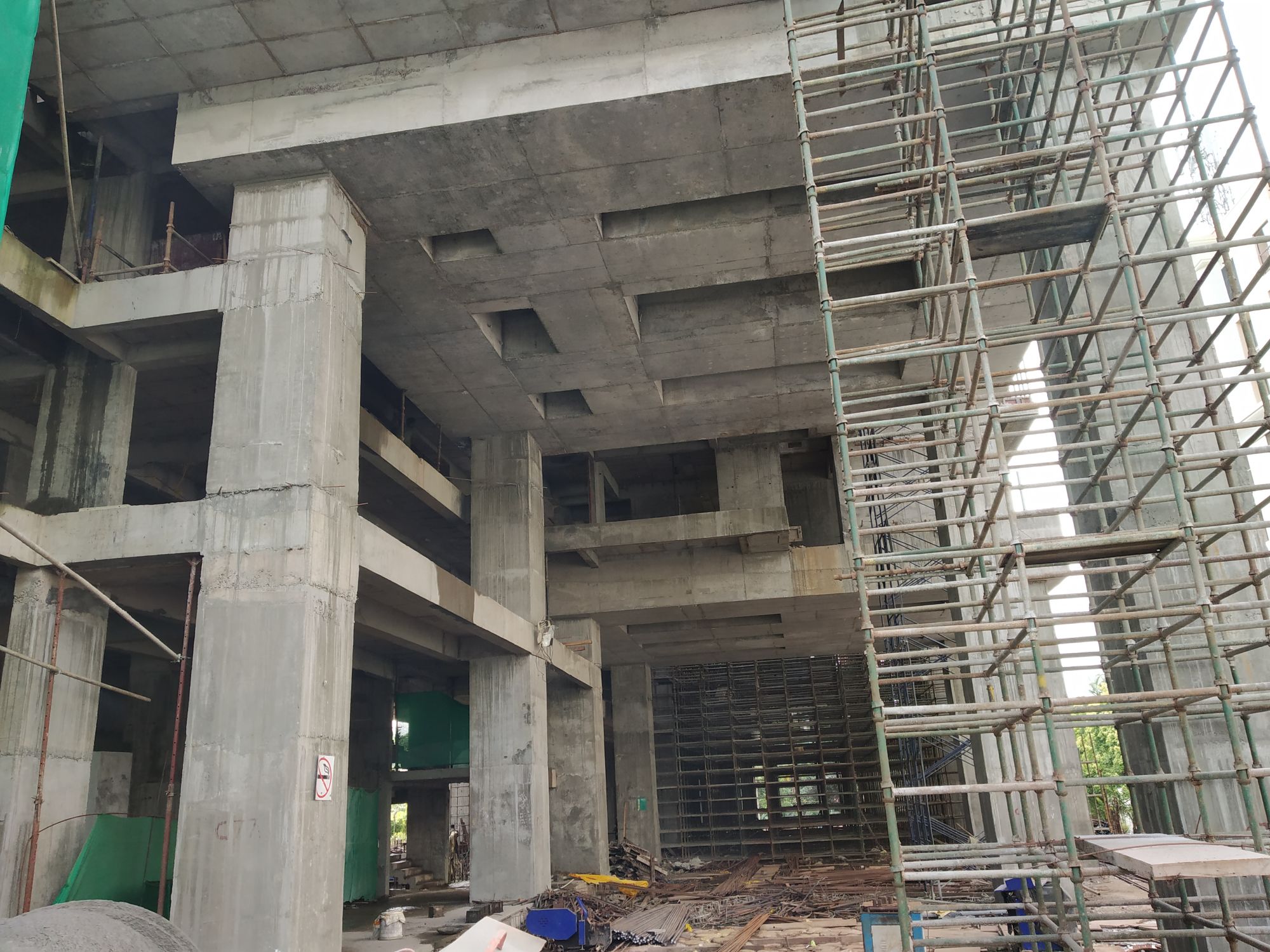

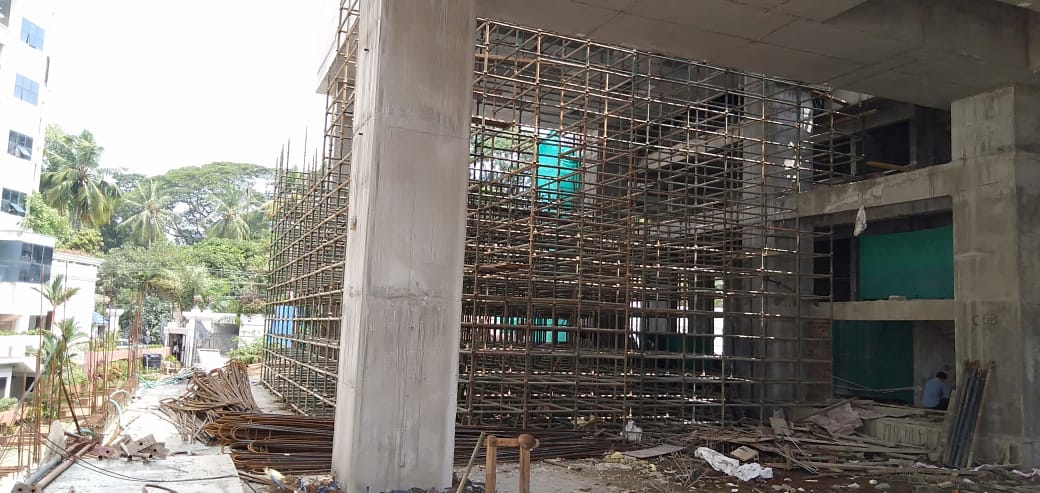

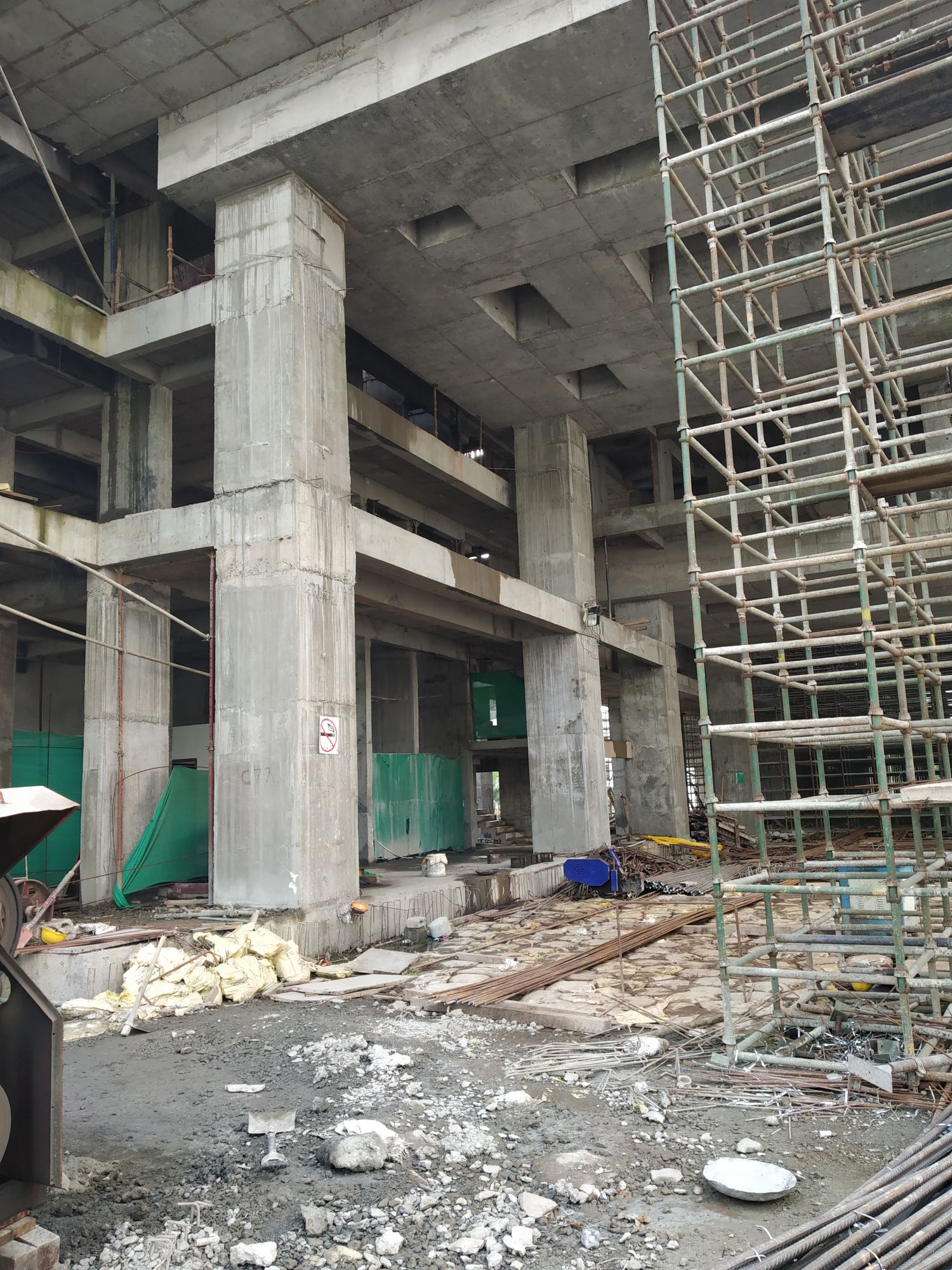

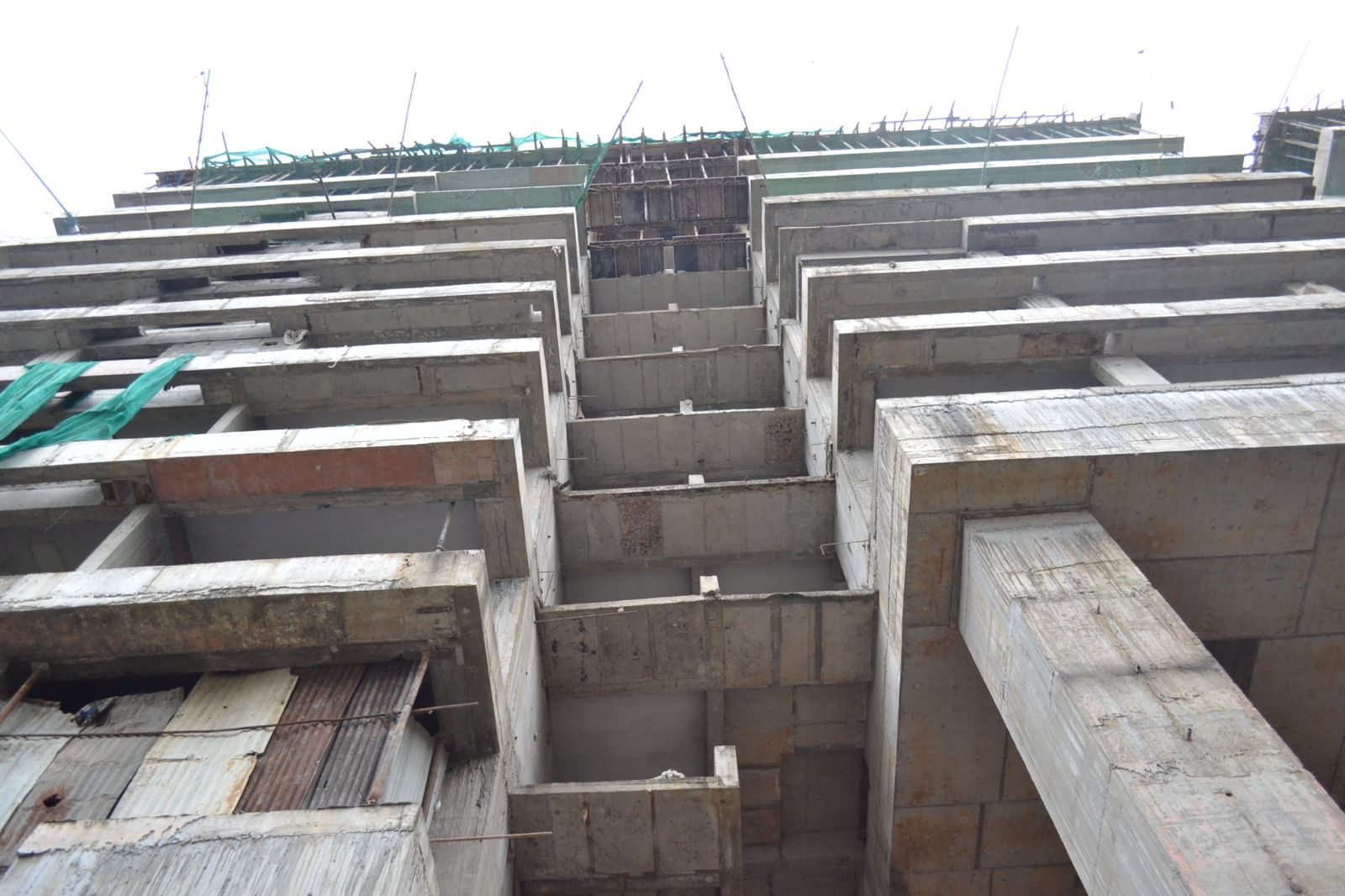

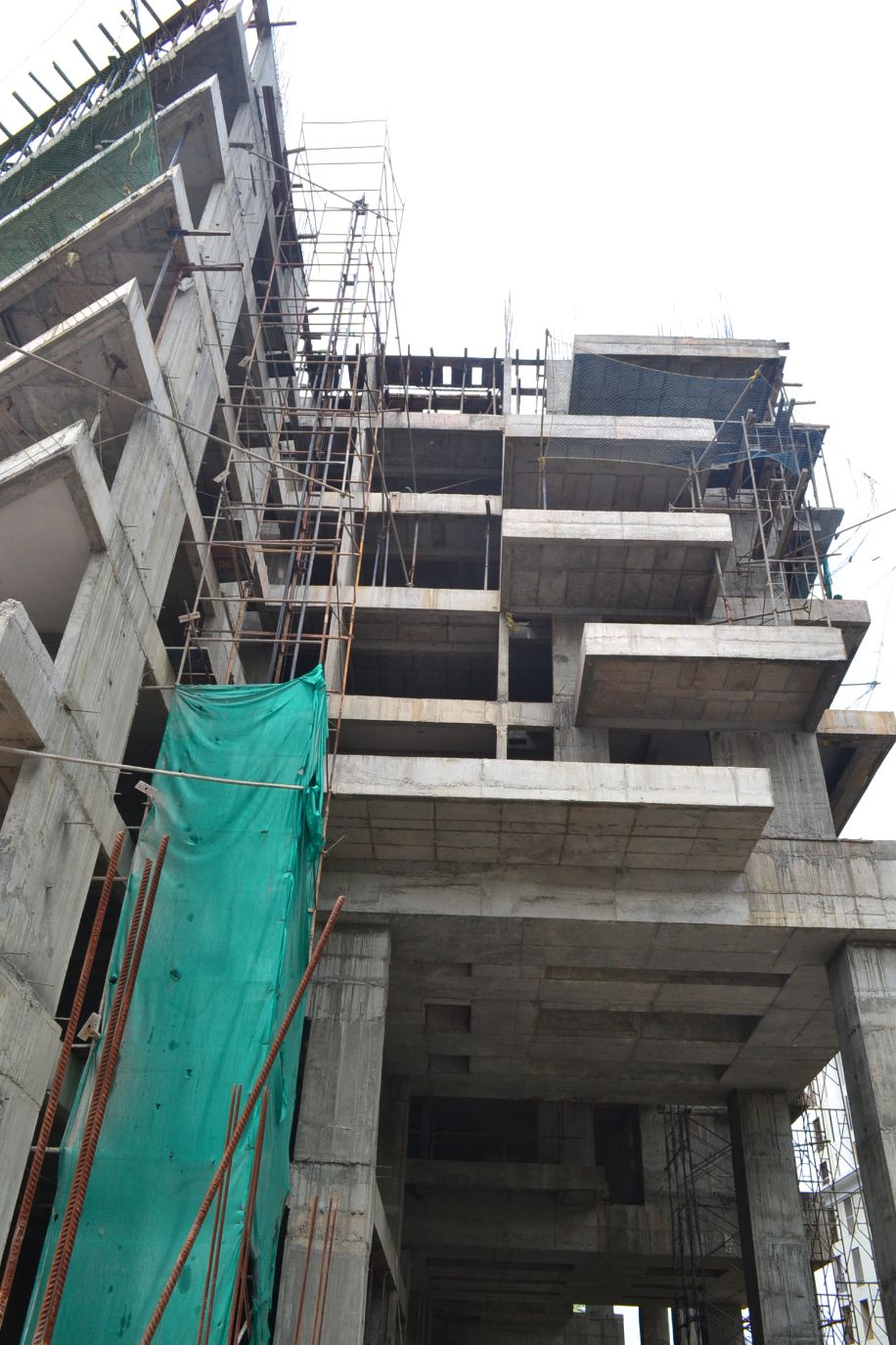

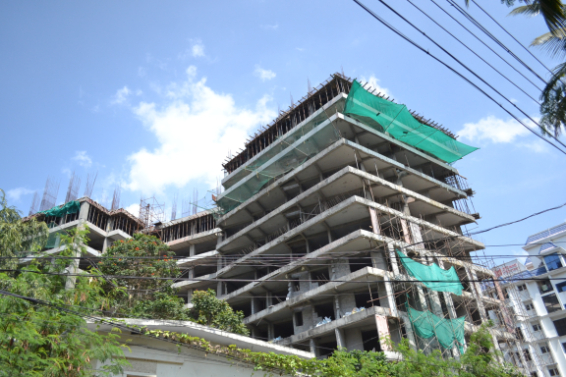

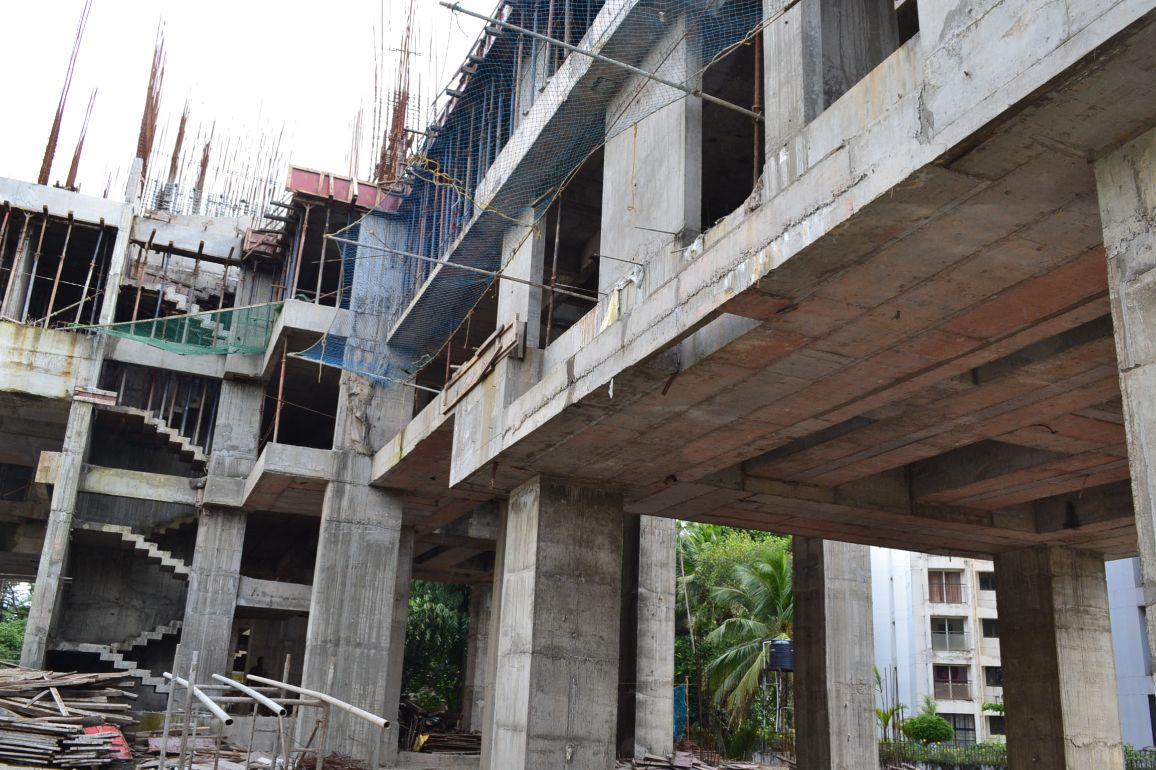

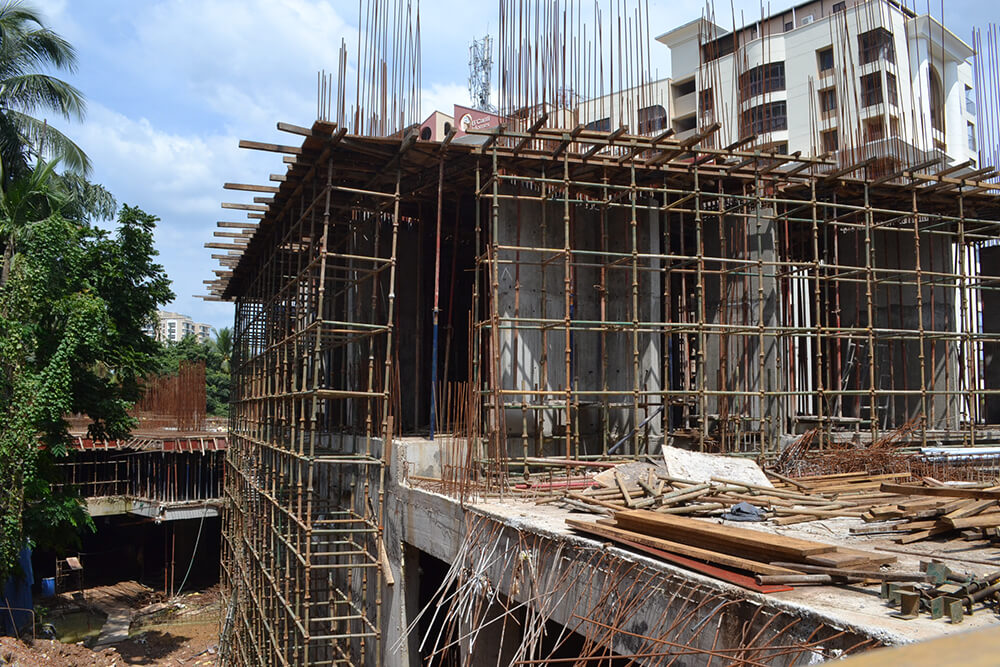

            • Second floor Column work – 53.50% completed
            • Third floor Column work-15% completed

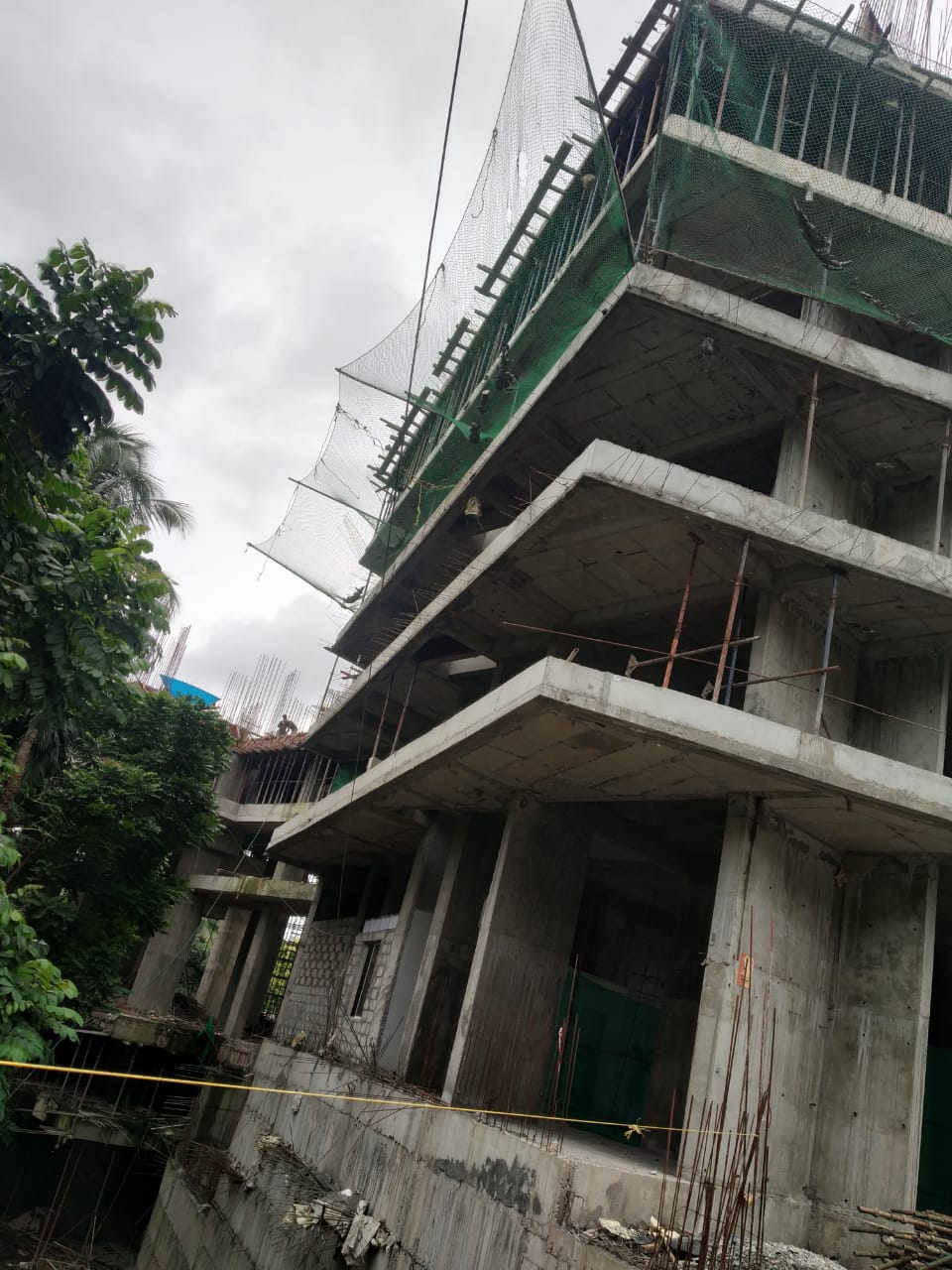

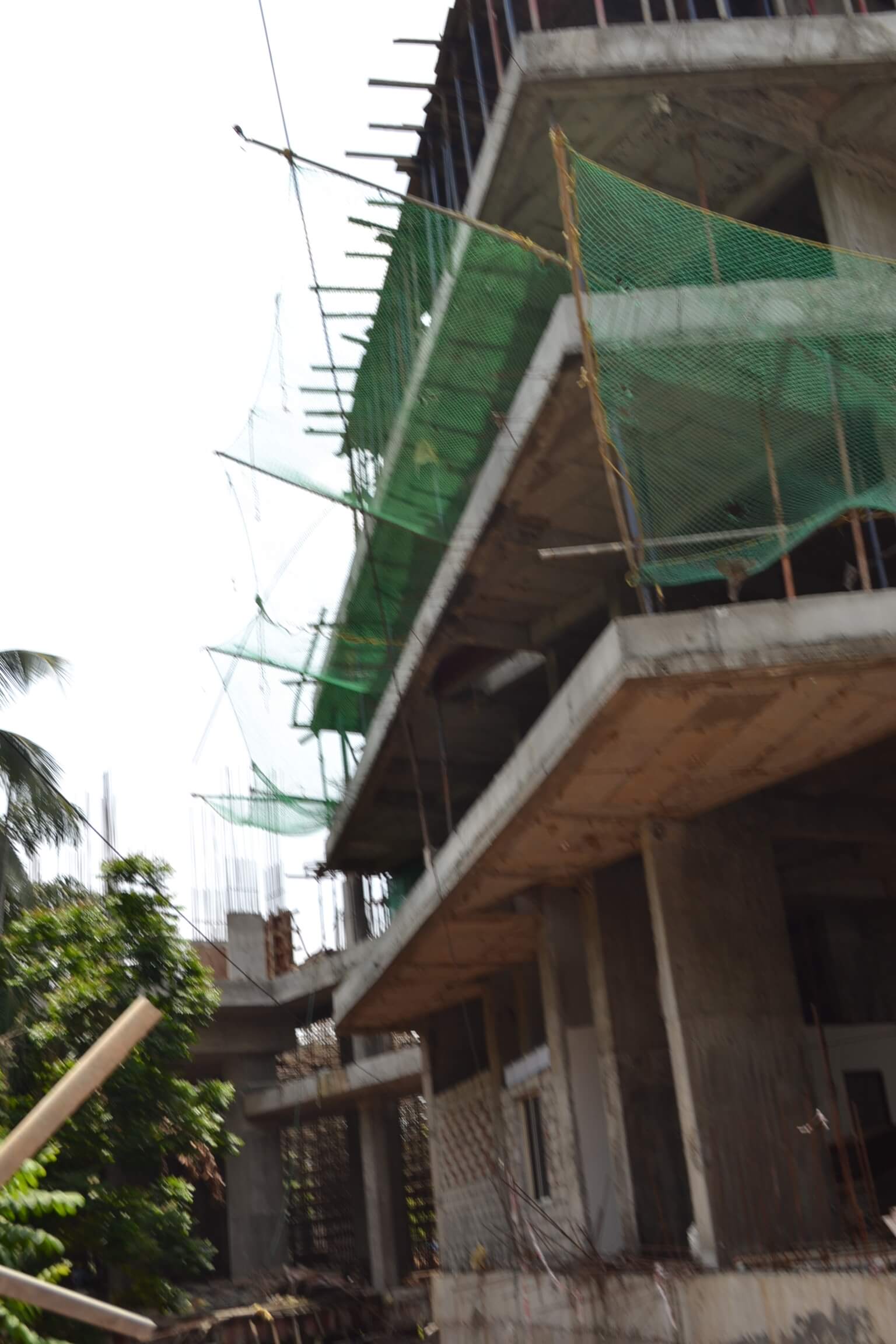

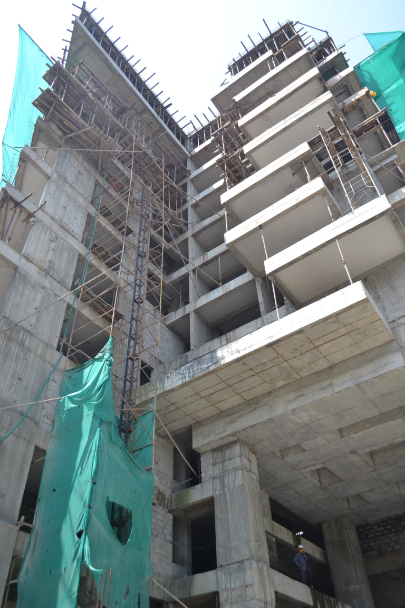

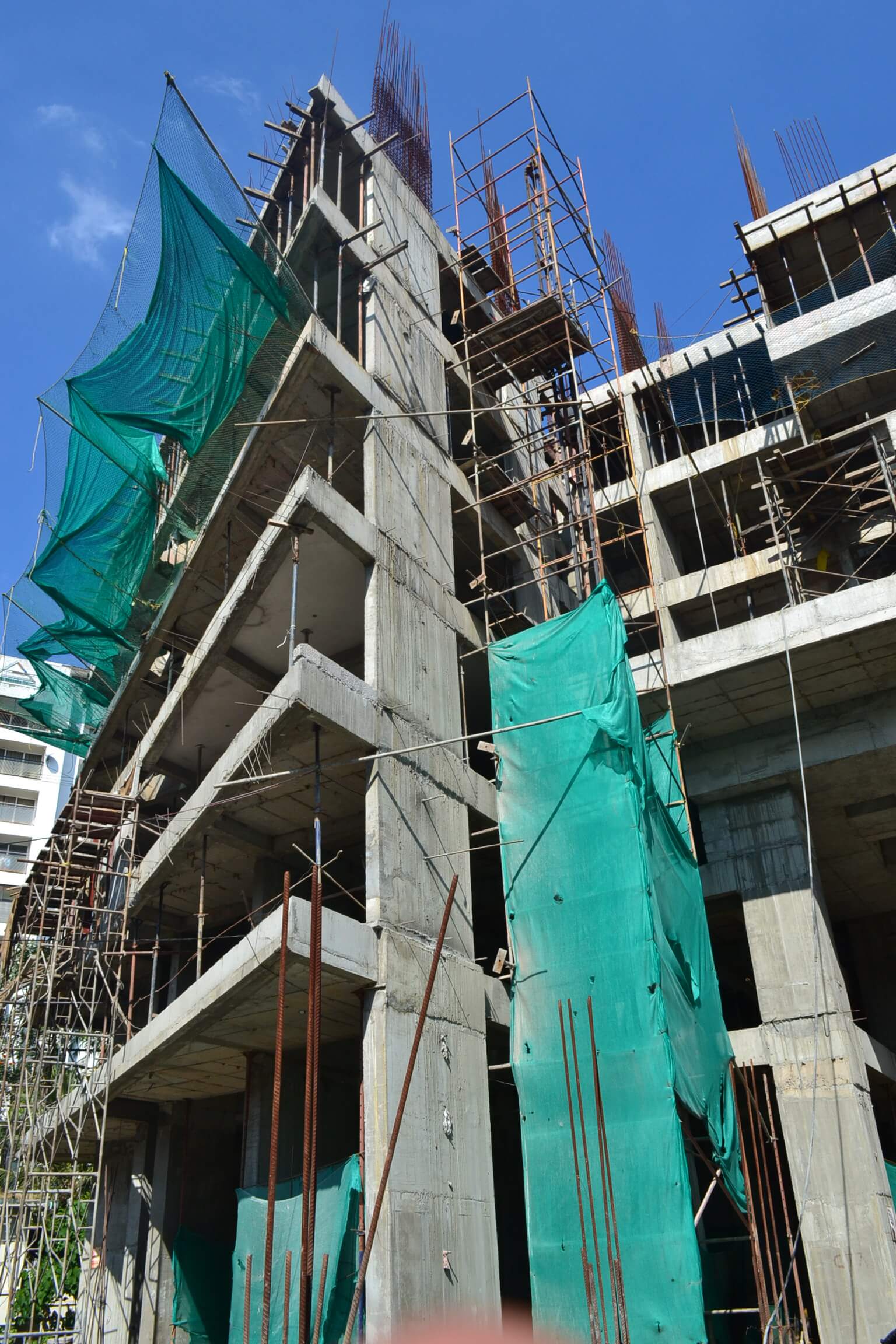

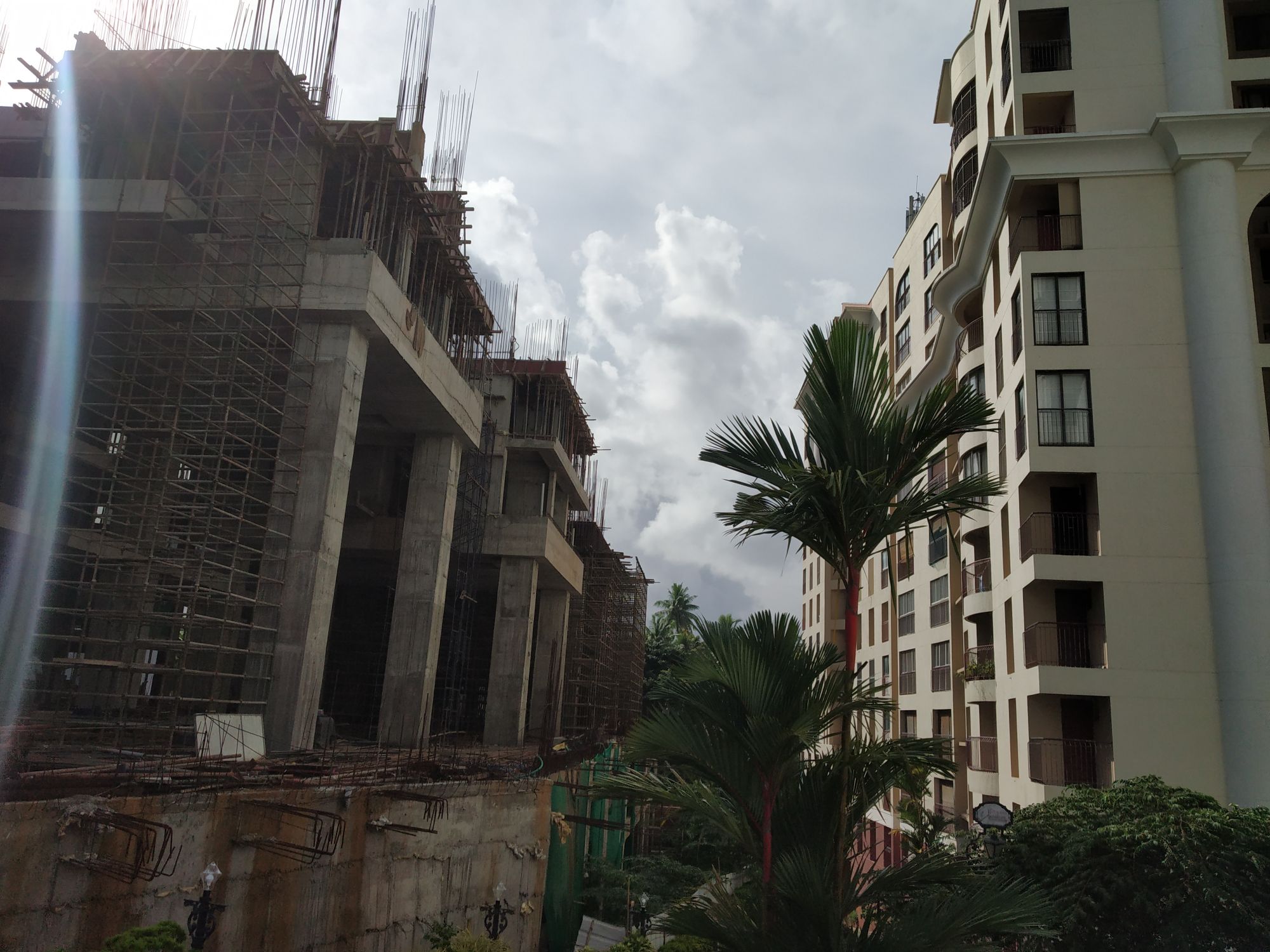

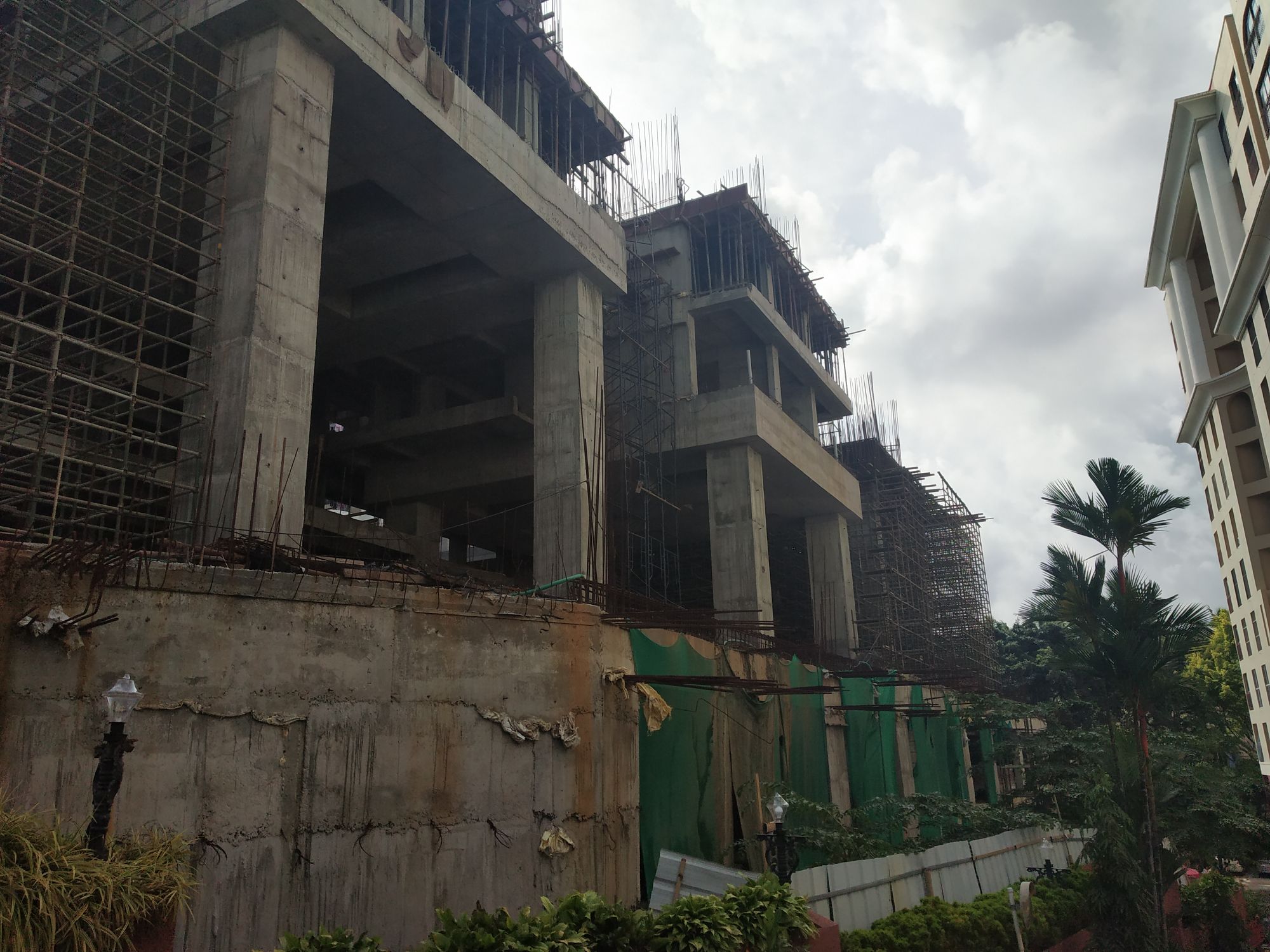

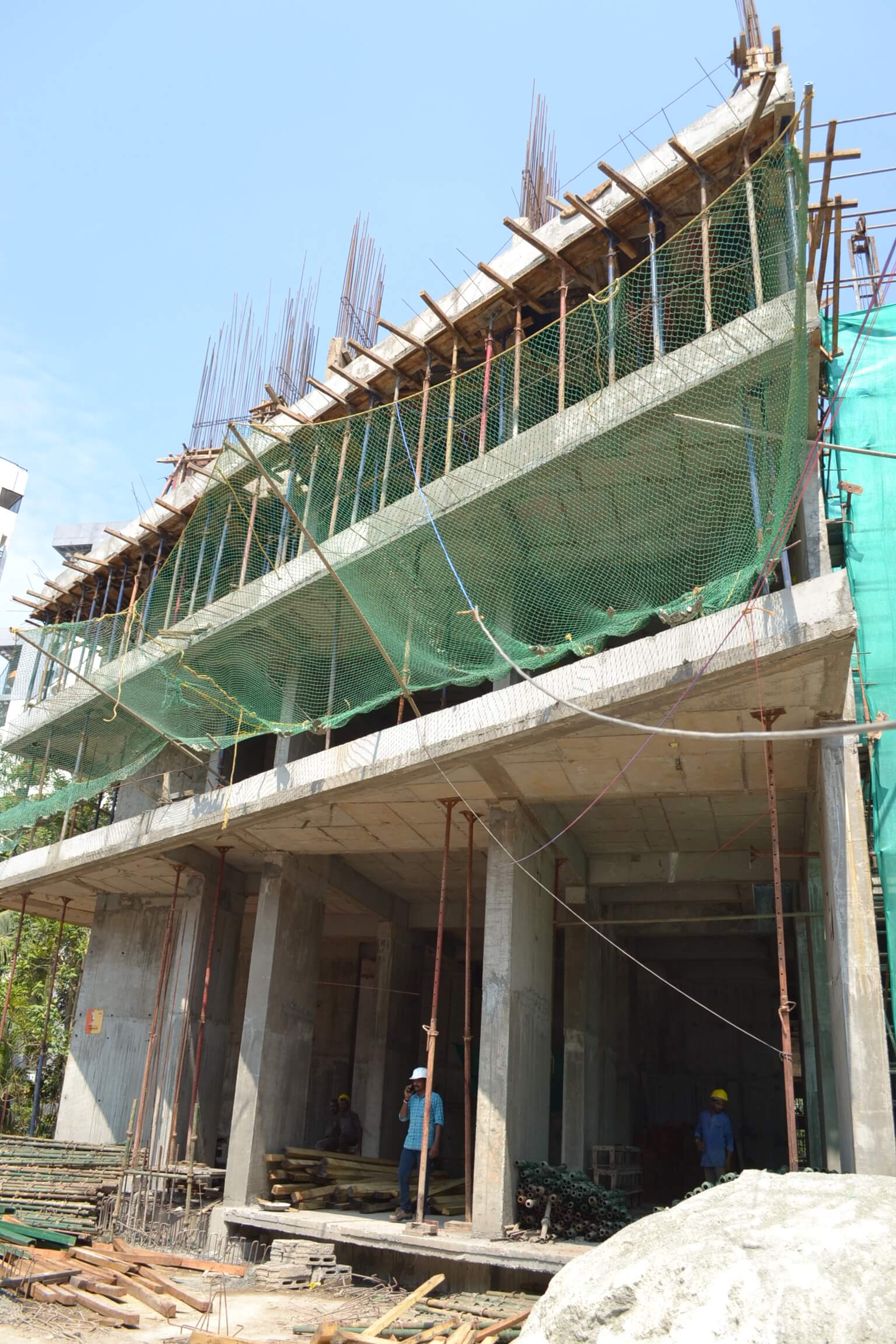

As per the current work status from our site we are targeted to complete the following works by end of April 2019

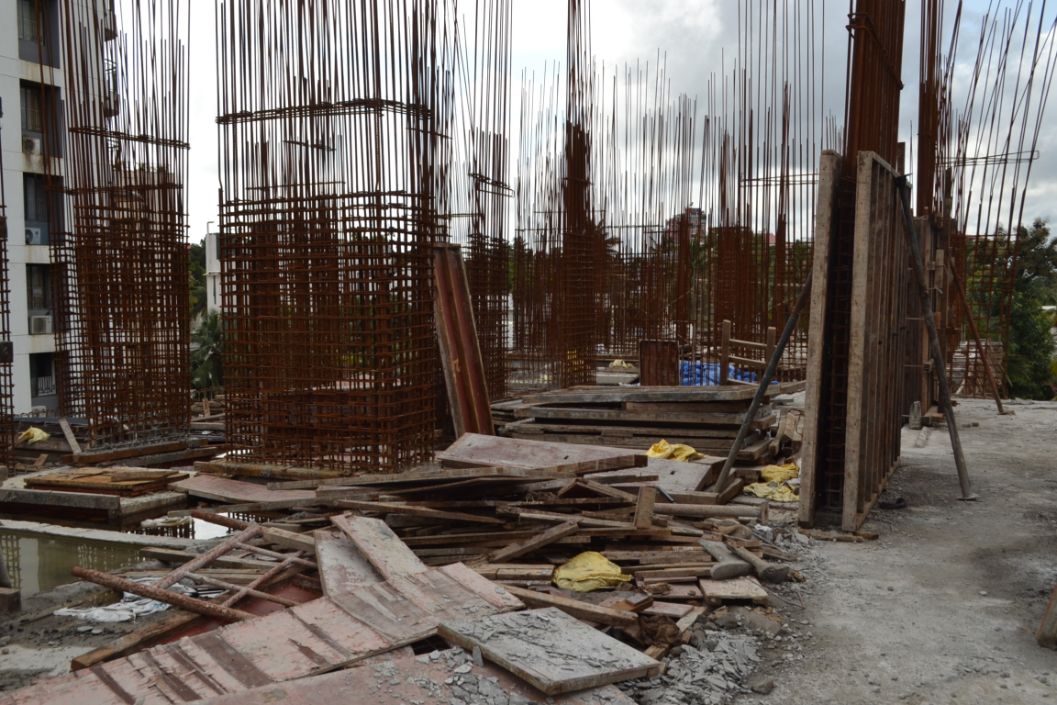

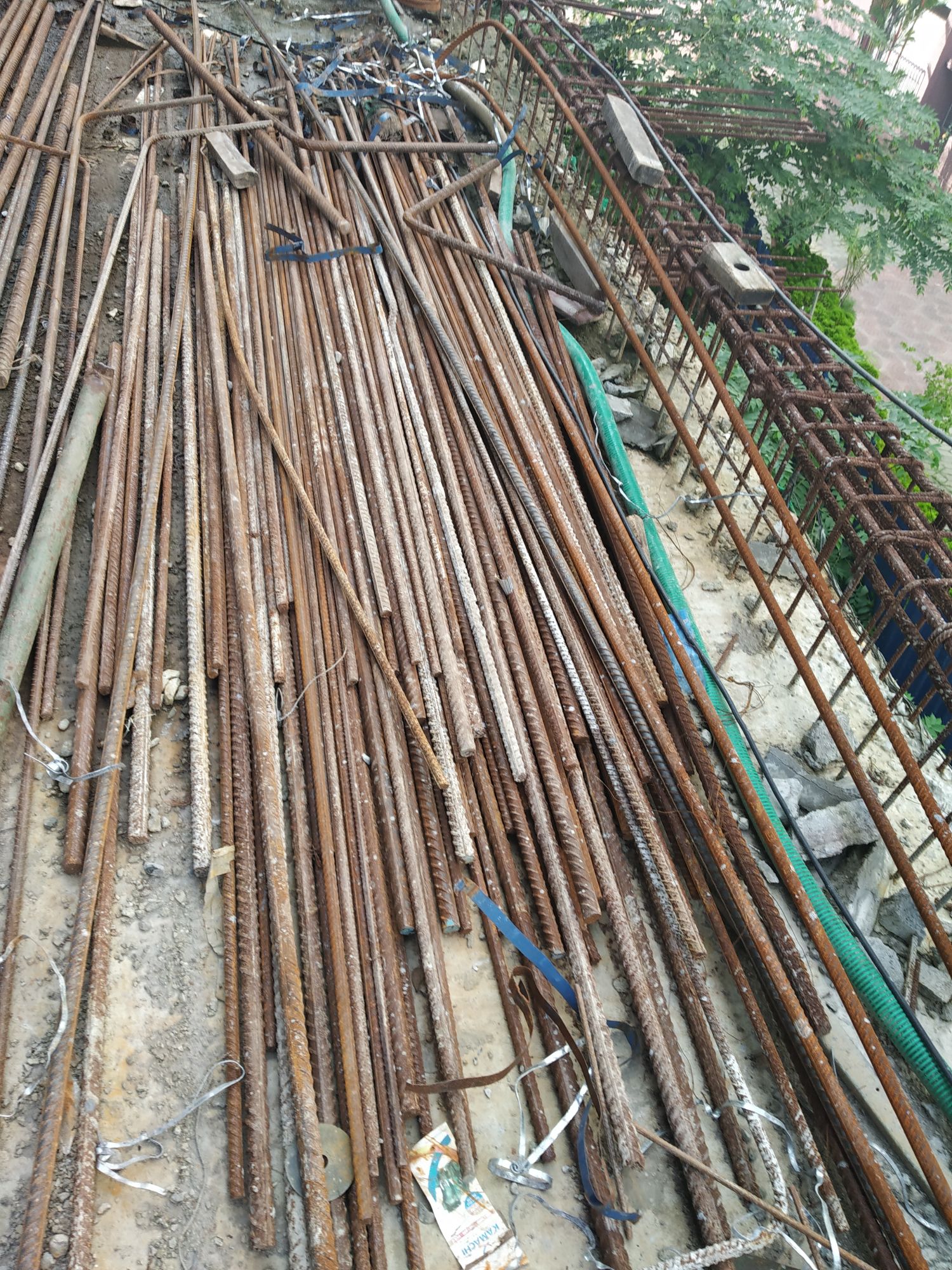

            • Pile chipping work -321 nos to be completed
            • Pile cap work – 68 to be completed (out of 72)
            • Second floor column work -40% completed
            • Second floor roof slab -40% to be completed

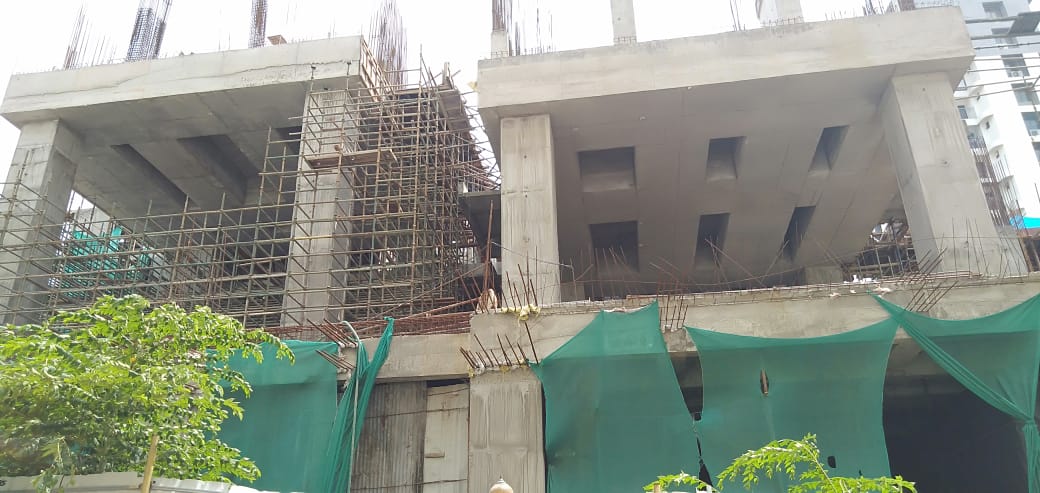

Work status as on 05.04.2019, we have completed the following

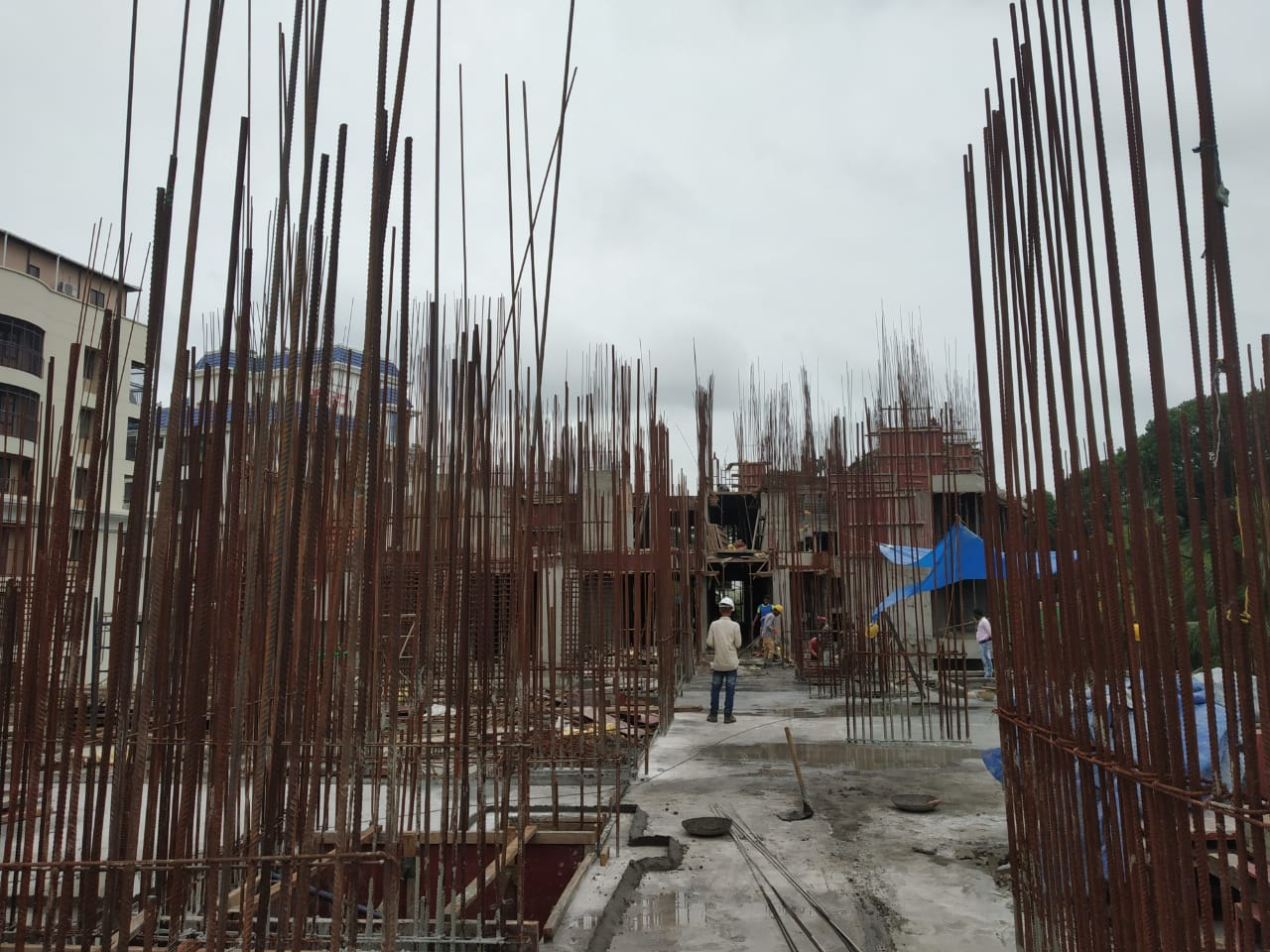

            • Piling work – 100% completed
            • Earth work – 90% completed
            • Pile chipping work – 319 nos completed (out of 323)
            • Pile cap work -66nos completed (out of 72)
            • Grade slab work – 100% completed
            • RCC for slab – BF2 roof slab – 100%completed.
            • BF1roof slab -RCC work 100% completed
            • Ground floor roof slabs -RCC Work100%completed.
            • First floor roof slab -100%completed

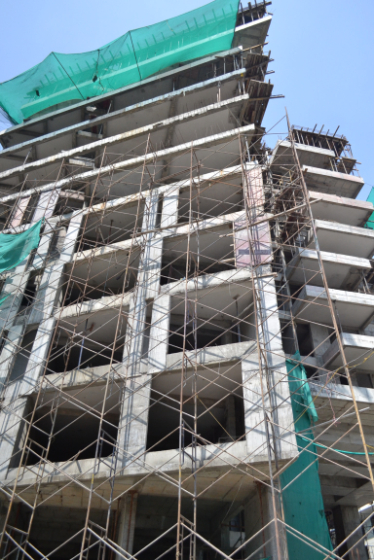

            • BF1 Column Rcc work -100% completed

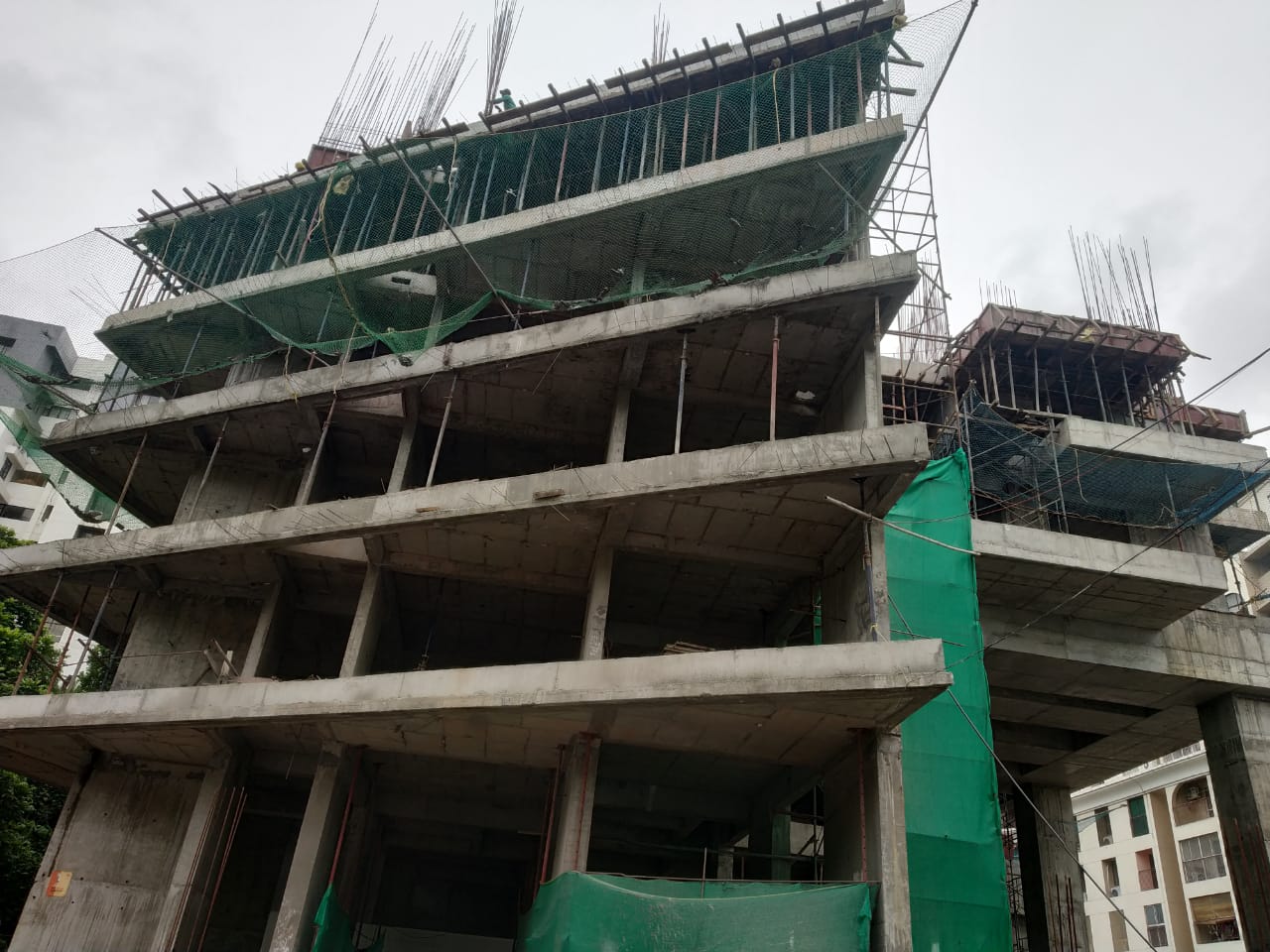

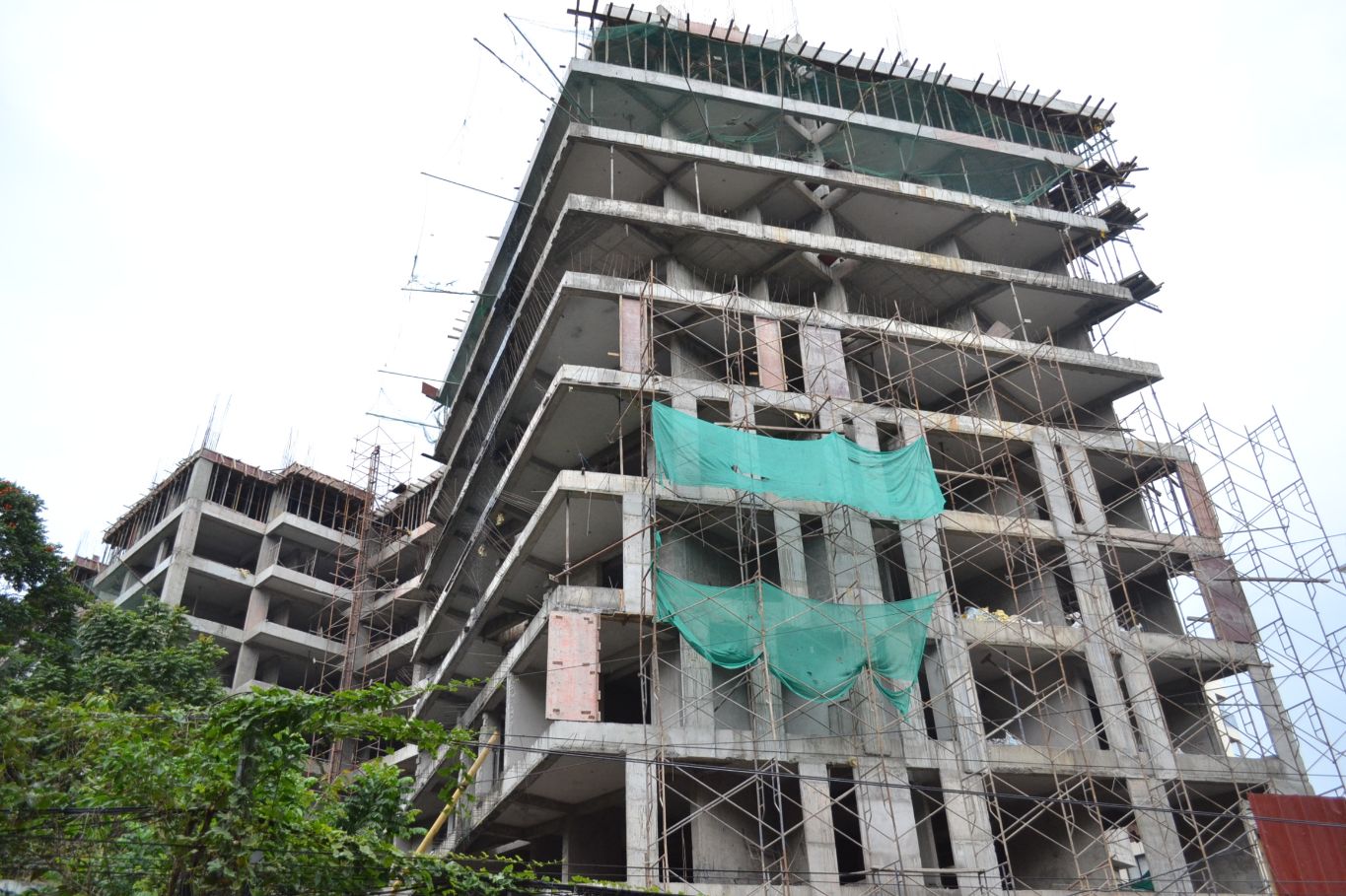

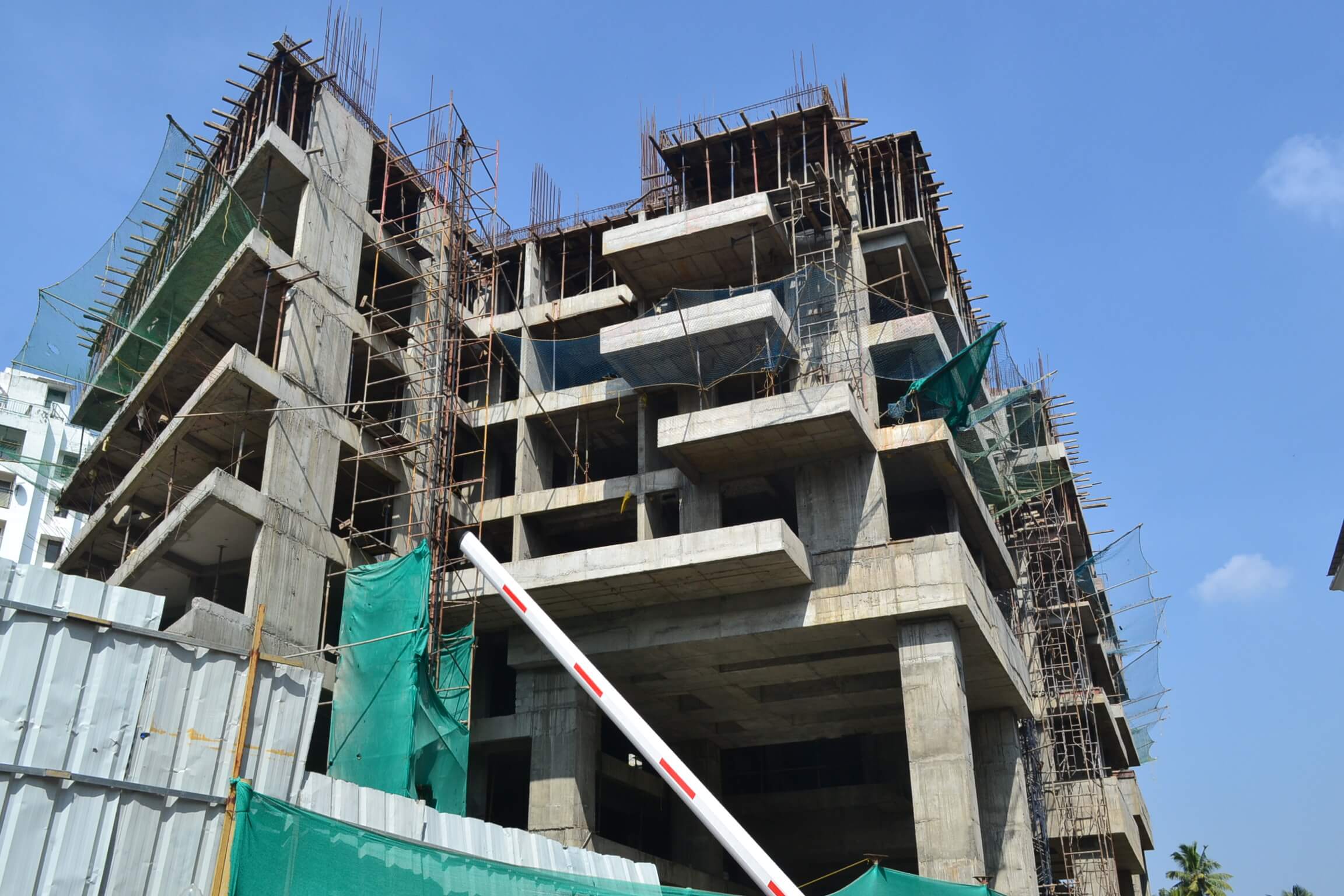

            • GF Column work – 100% completed
            • First Floor Column work-100% completed
            • Second floor column work -20% completed
            • Second floor roof slab -20%completed

As per the current work status from our site we are targeted to complete the following works by end of March 2019

            • Second floor roof slab -40% to be completed
            • Pile chipping work -321 nos to be completed
            • Pile cap work – 100% to be completed (out of 72)

Work status as on 06-03-2019, we have completed the following

            • Piling work – 100% completed
            • Earth work – 90% completed
            • Pile chipping work – 319 nos completed (out of 323)
            • Pile cap work – 69 nos completed (out of 72)
            • Grade slab work – 100% completed
            • RCC for slab – BF2 roof slab – 100%completed.
            • BF1 roof slab -RCC work 100% completed
            • Ground floor roof slabs -RCC Work 100%completed.
            • First floor roof slab -100%completed

            • Rear Portion Transfer Slab -100% completed
            • BF1 Column Rcc work -100% completed
            • GF Column work – 100% completed
            • First Floor Column work-100% completed
            • Second floor roof slab -20%completed

As per the current work status from our site we are targeted to complete the following works by end of February 2019

            • Pile chipping work – 100% to be completed
            • Pile cap work – 100% to be completed (out of 72)
            • Rear Portion Transfer Slab -100% to be completed
            • Second floor roof slab -40% to be completed

Work status as on 05-02-2019, we have completed the following

            • Piling work – 100% completed
            • Earth work – 90% completed
            • Pile chipping work – 317 nos completed (out of 323)
            • Pile cap work – 69nos completed (out of 72)
            • Grade slab work – 100% completed
            • RCC for slab – BF2 roof slab – 100%completed.
            • BF1 roof slab -RCC work 100% completed
            • Ground floor roof slabs -RCC Work100%completed.
            • First floor roof slab -100%completed
            • Rear Portion Transfer Slab -90% completed
            • BF1 Column Rcc work -100% completed
            • GF Column work – 100% completed
            • First Floor Column work-100% completed
            • Second floor roof slab -20%completed

As per the current work status from our site we are targeted to complete the following works by end of January 2019

            • Earth work – 100% to be completed
            • Pile cap work – 67 nos to be completed (out of 72)
            • Rear Portion Transfer Slab -100% to be completed

Work status as on 08-01-2019, we have completed the following

            • Piling work – 100% completed
            • Earth work – 90% completed
            • Pile chipping work – 317 nos completed (out of 323)
            • Pile cap work – 66 nos completed (out of 72)
            • Grade slab work – 100% completed
            • RCC for slab – BF2 roof slab – 100%completed.
            • BF1roof slab -RCC work 100% completed
            • Ground floor roof slabs -RCC Work100%completed.

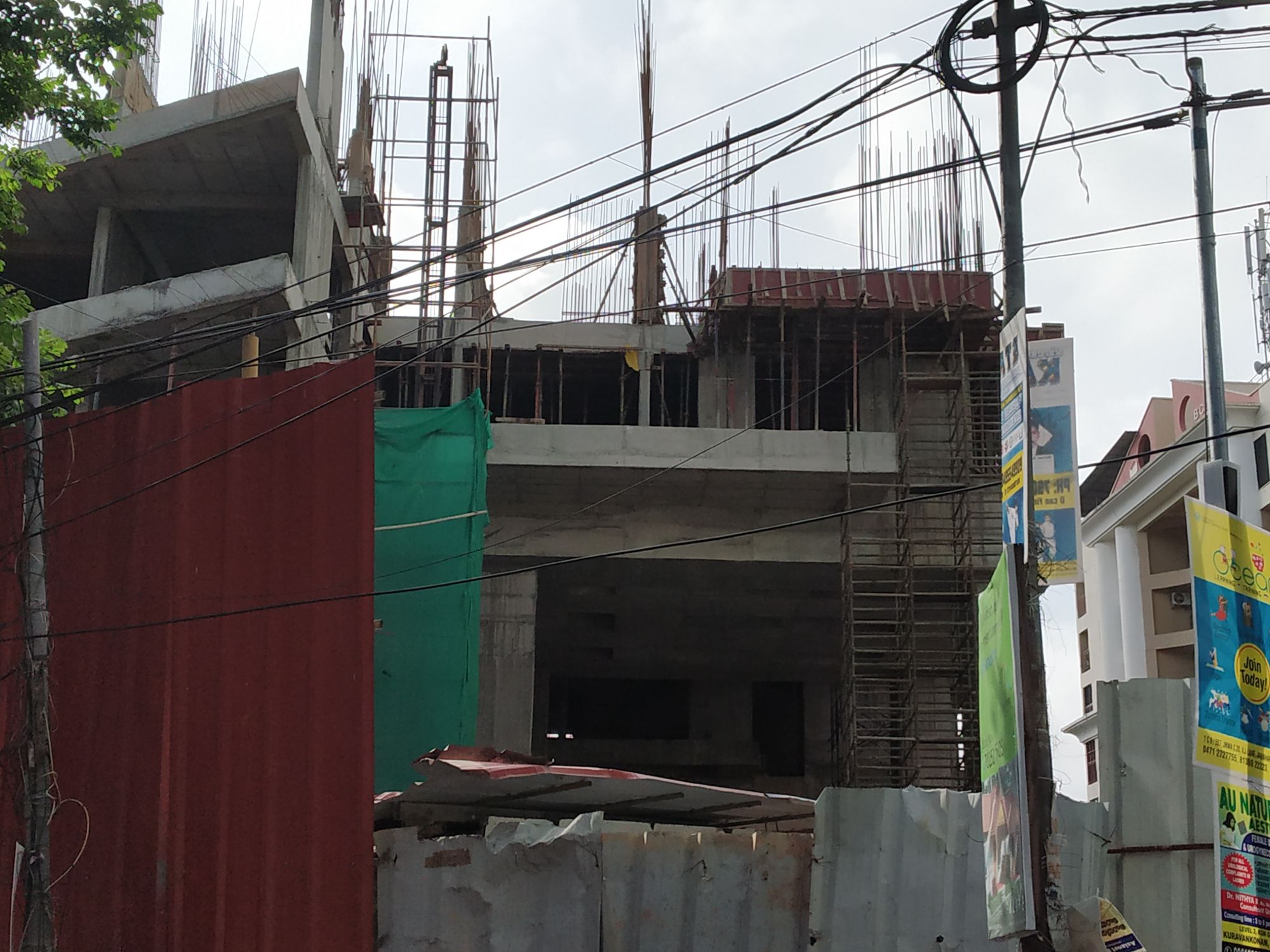

            • First floor roof slab -60%completed
            • Rear Portion Transfer Slab -50% completed
            • BF1 Column Rcc work -100% completed
            • GF Column work – 100% completed

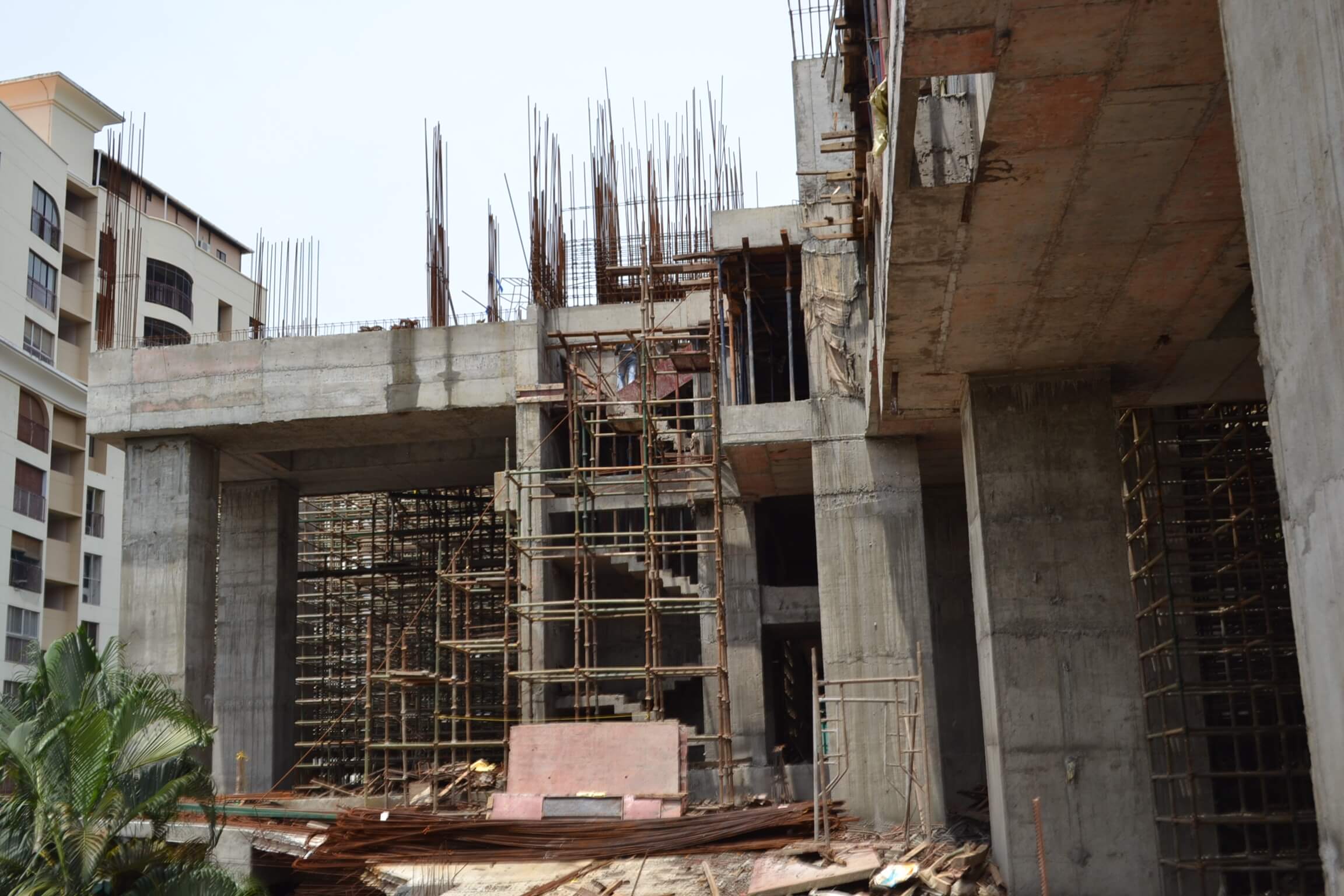

            • First Floor Column work-60% completed

As per the current work status from our site we are targeted to complete the following works by end of December 2019

            • Earth work – 100% to be completed
            • Pile cap work – 67 nos to be completed (out of 72)
            • First floor roof slab (A flat portion)-100% to be completed
            • Rear Portion Transfer slab -100% to be completed.
            • GF Column work – 100% to be completed

Work status as on 06-12-2018, we have completed the following

            • Piling work – 100% completed
            • Earth work – 90% completed
            • Pile chipping work – 317 nos completed (out of 323)
            • Pile cap work – 66 nos completed (out of 72)
            • Grade slab work – 100% completed
            • RCC for slab – BF2 roof slab – 100%completed.
            • Ground floor slab RCC Work-100%completed.
            • BF1 Column Rcc work -100% completed
            • BF1 roof slab work – 100% completed

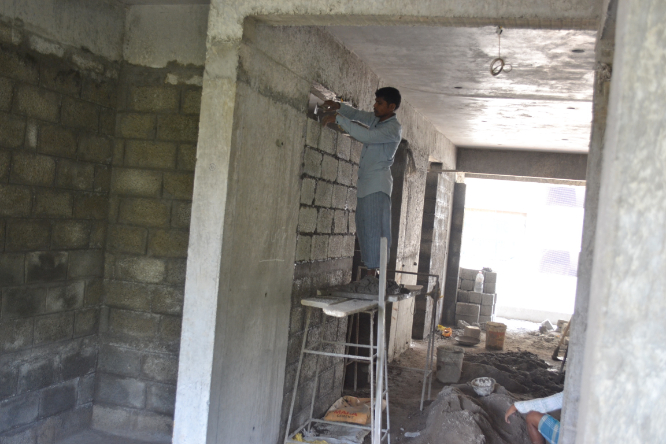

            • GF Column work – 85% completed
            • First Floor Column work-10% completed

As per the current work status from our site we are targeted to complete the following works by end of November 2018

            • Earth work – 100% to be completed
            • Pile cap work – 67 nos to be completed (out of 72)
            • Grade slab work – 100% to be completed
            • RCC for slab – BF2 roof slab – 100% to be completed
            • B1 Column Rcc work – 100% to be completed
            • BF1 roof slab work – 100% to be completed
            • GF Column work – 50% to be completed
            • GF Slab RCC work – 50% to be completed

Work status as on 16-11-2018, we have completed the following

            • Piling work – 100% completed
            • Earth work – 90% completed
            • Pile chipping work – 317 nos completed (out of 323)
            • Pile cap work – 66 nos completed (out of 72)
            • Grade slab work – 94% completed

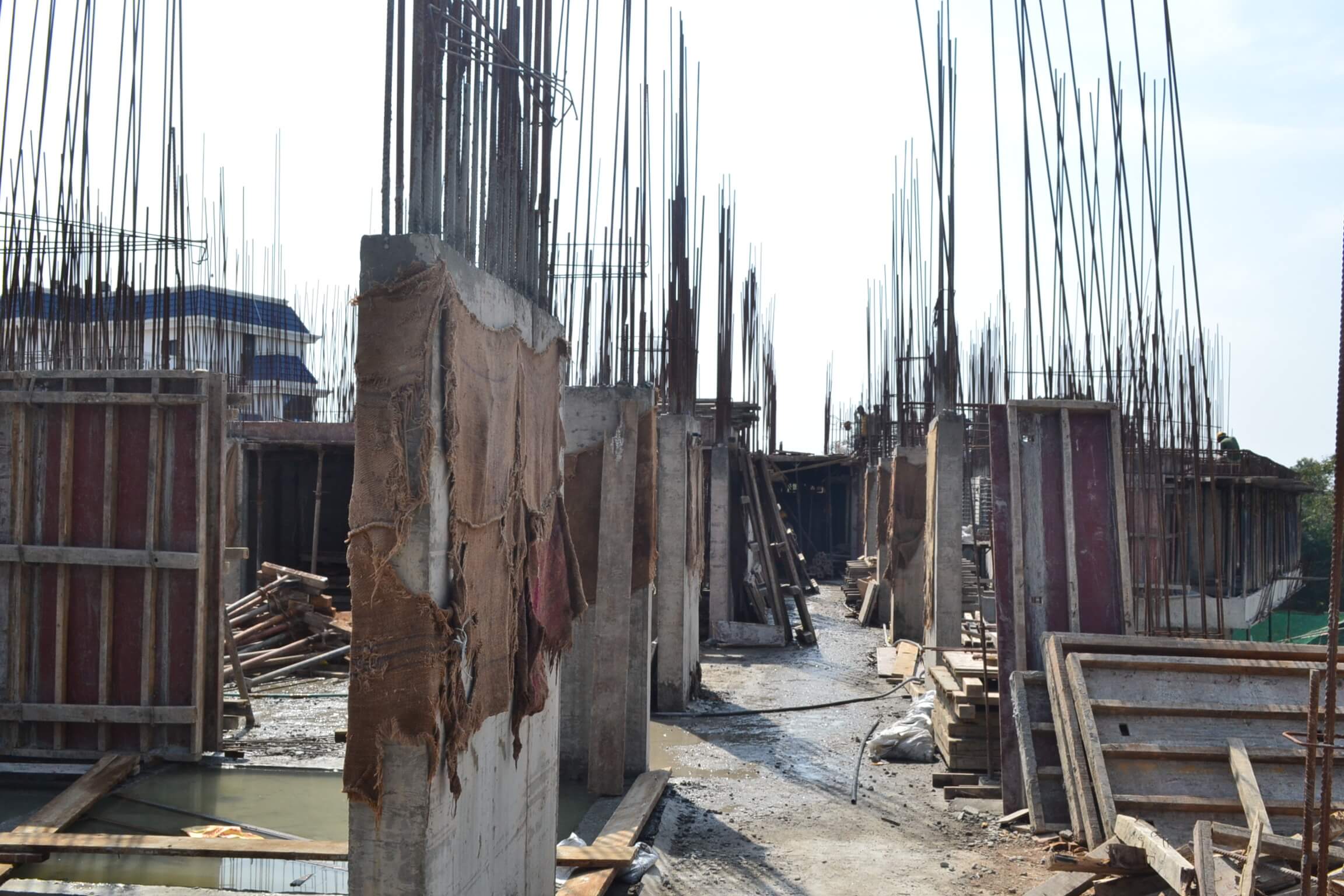

            • RCC for slab – BF2 roof slab – 90% completed
            • BF1 Column Rcc work – 95% completed
            • BF1 roof slab work – 95% completed
            • GF Column work – 25% completed
            • GF Slab RCC work – 10% completed

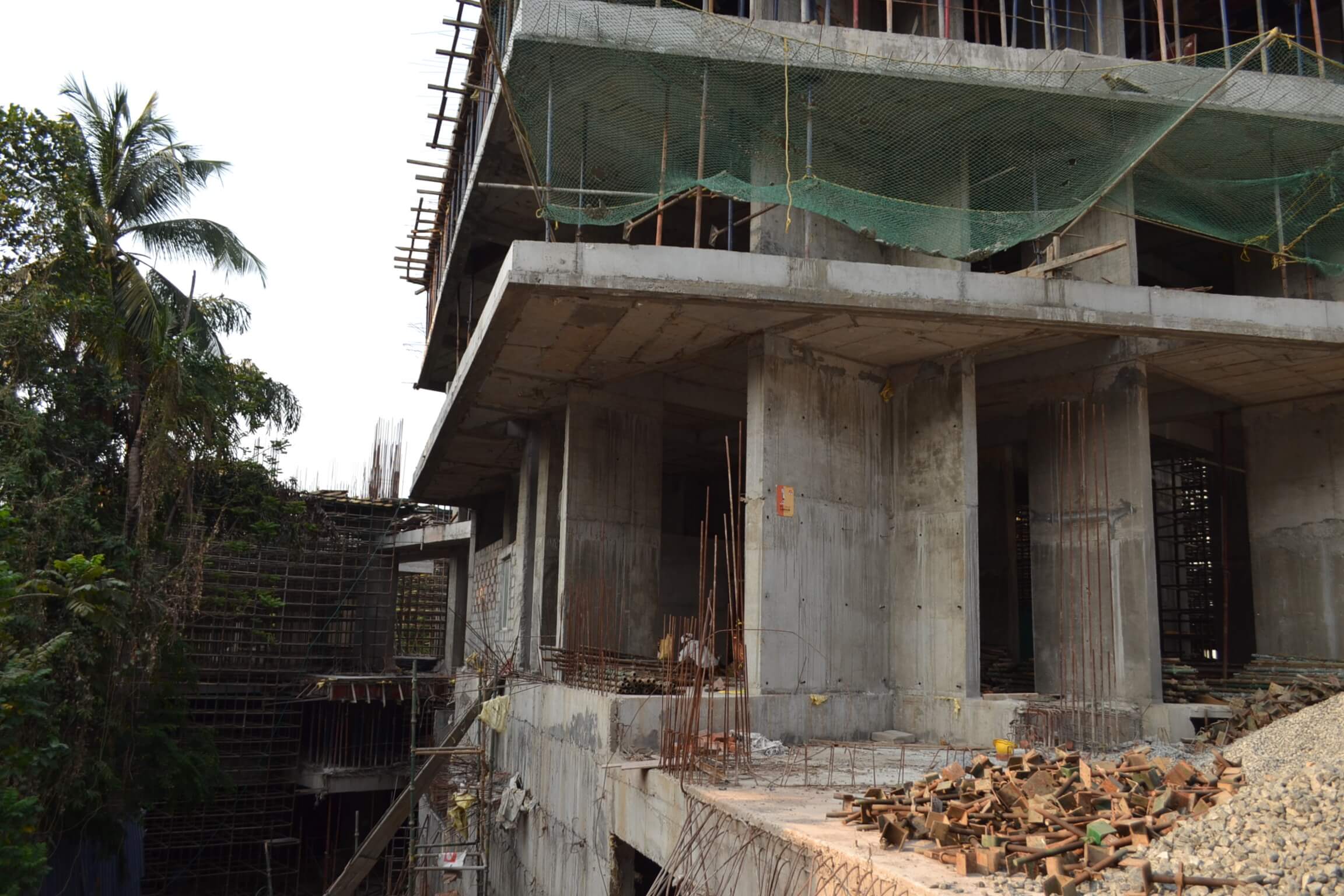

As per the current work status from our site we are targeted to complete the following works by end of May 2018

            • Earth work – 100% to be completed
            • Pile chipping work – 315nos to be completed (out of 323)
            • Pile cap work – 66 nos to be completed (out of 72)
            • Grade slab work – 100% to be completed

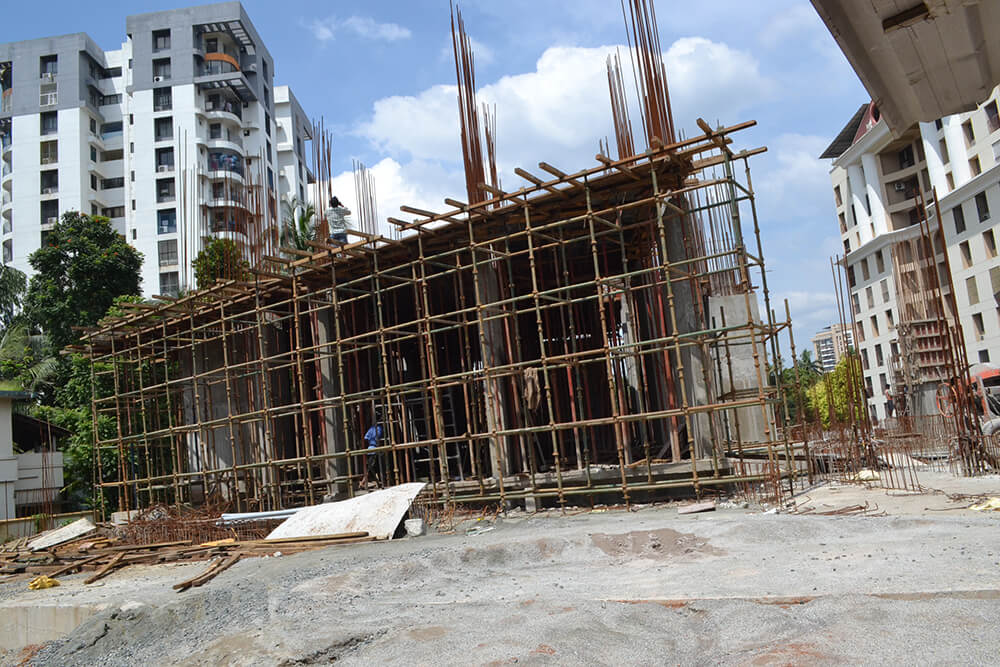

            • RCC for slab – BF- 30% to be completed

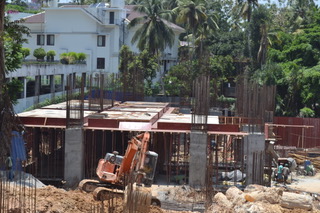

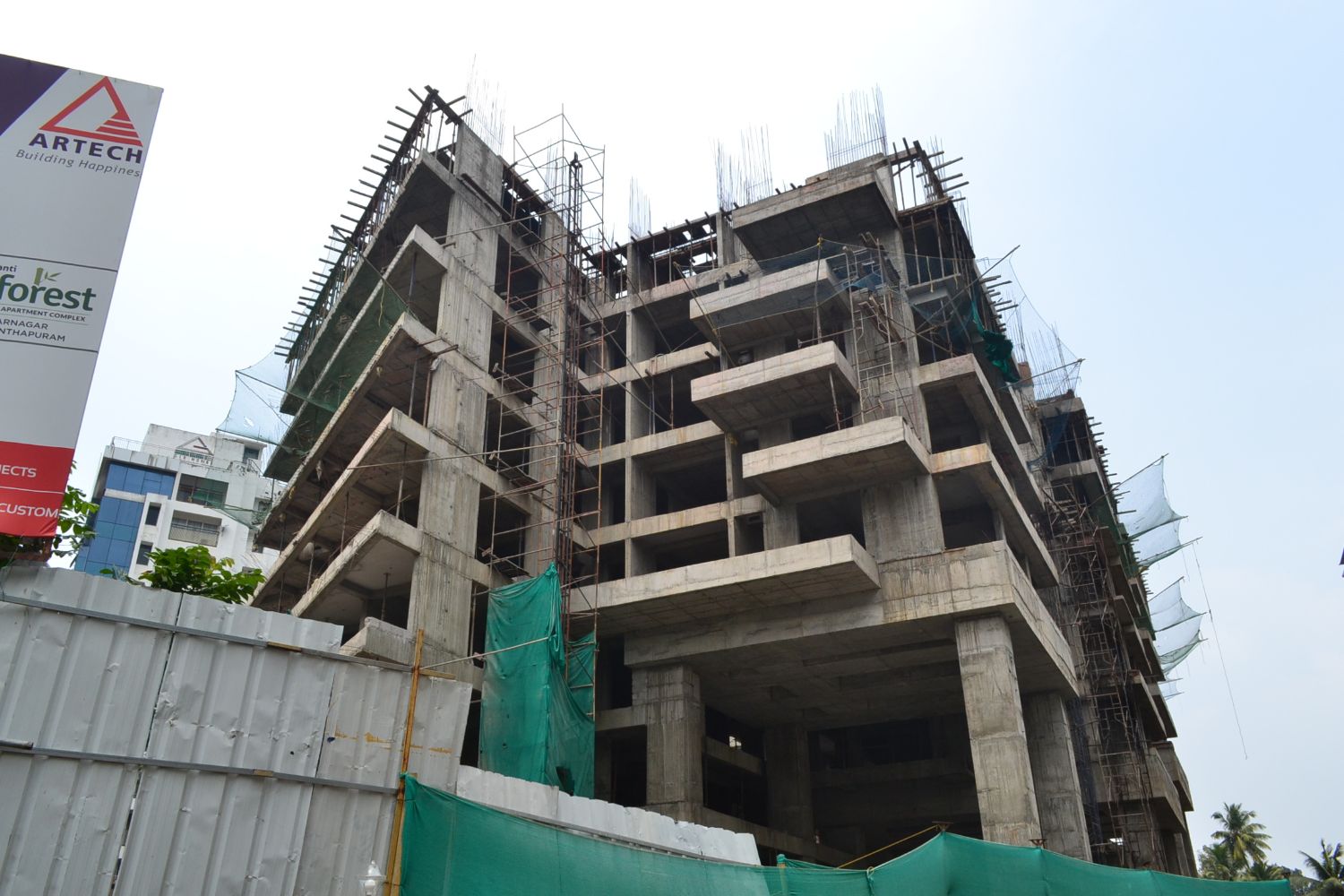

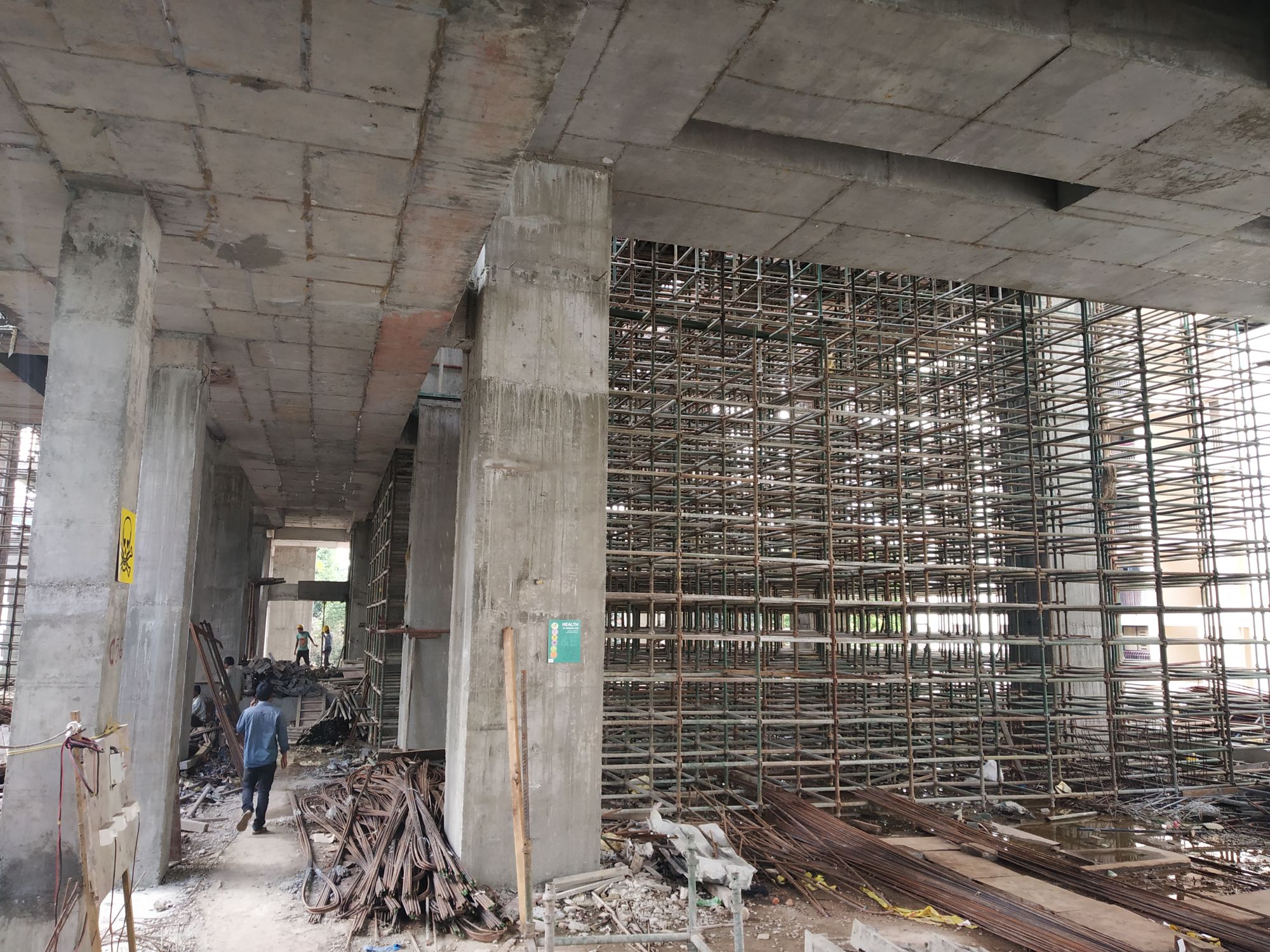

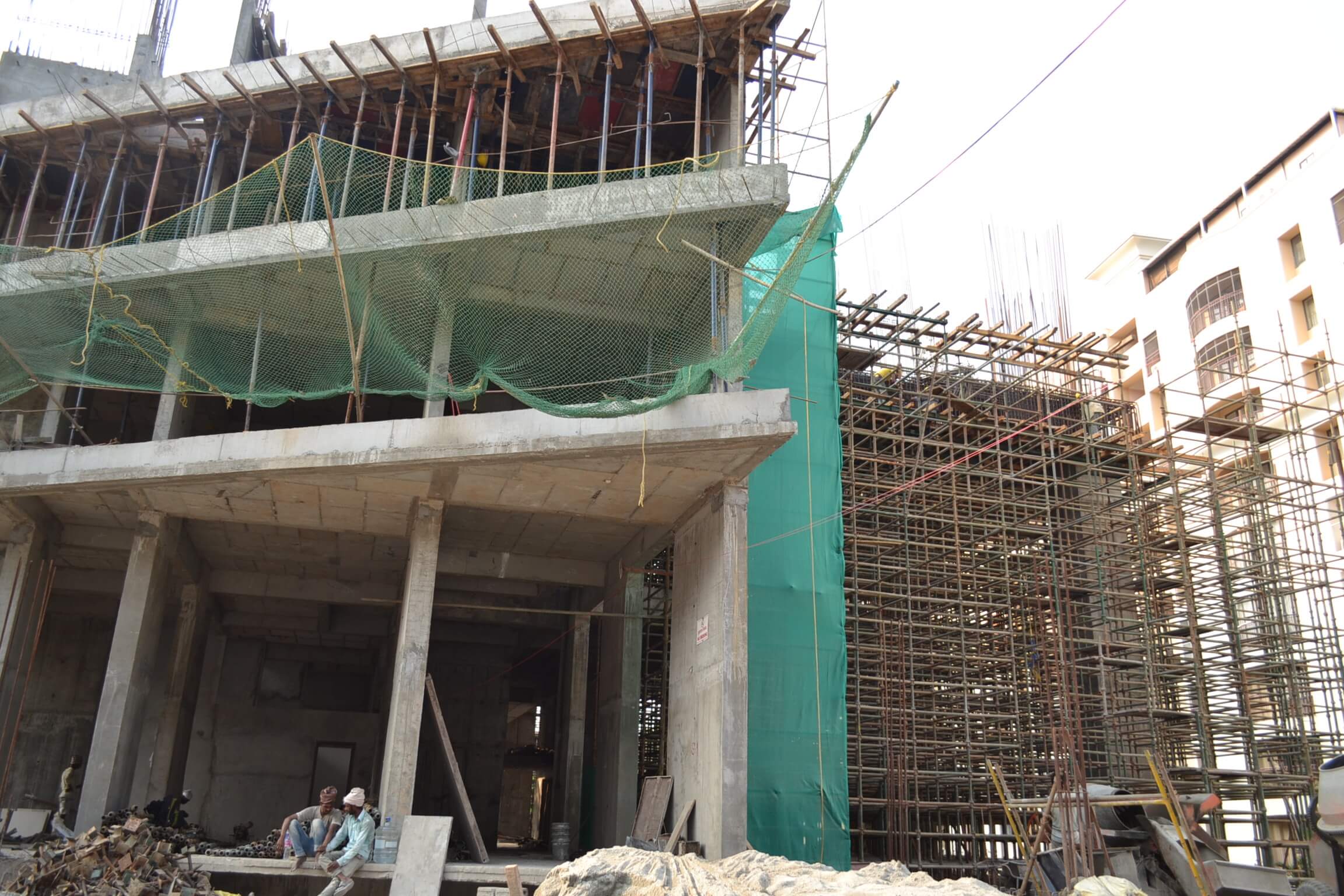

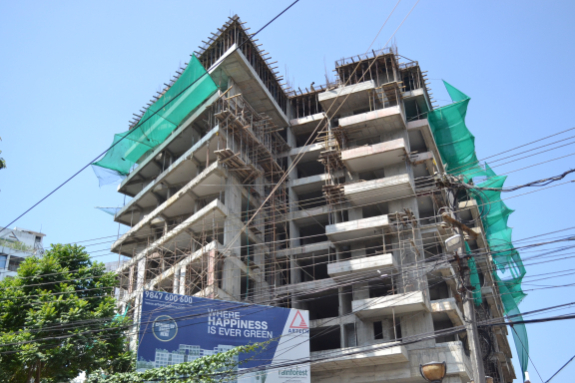

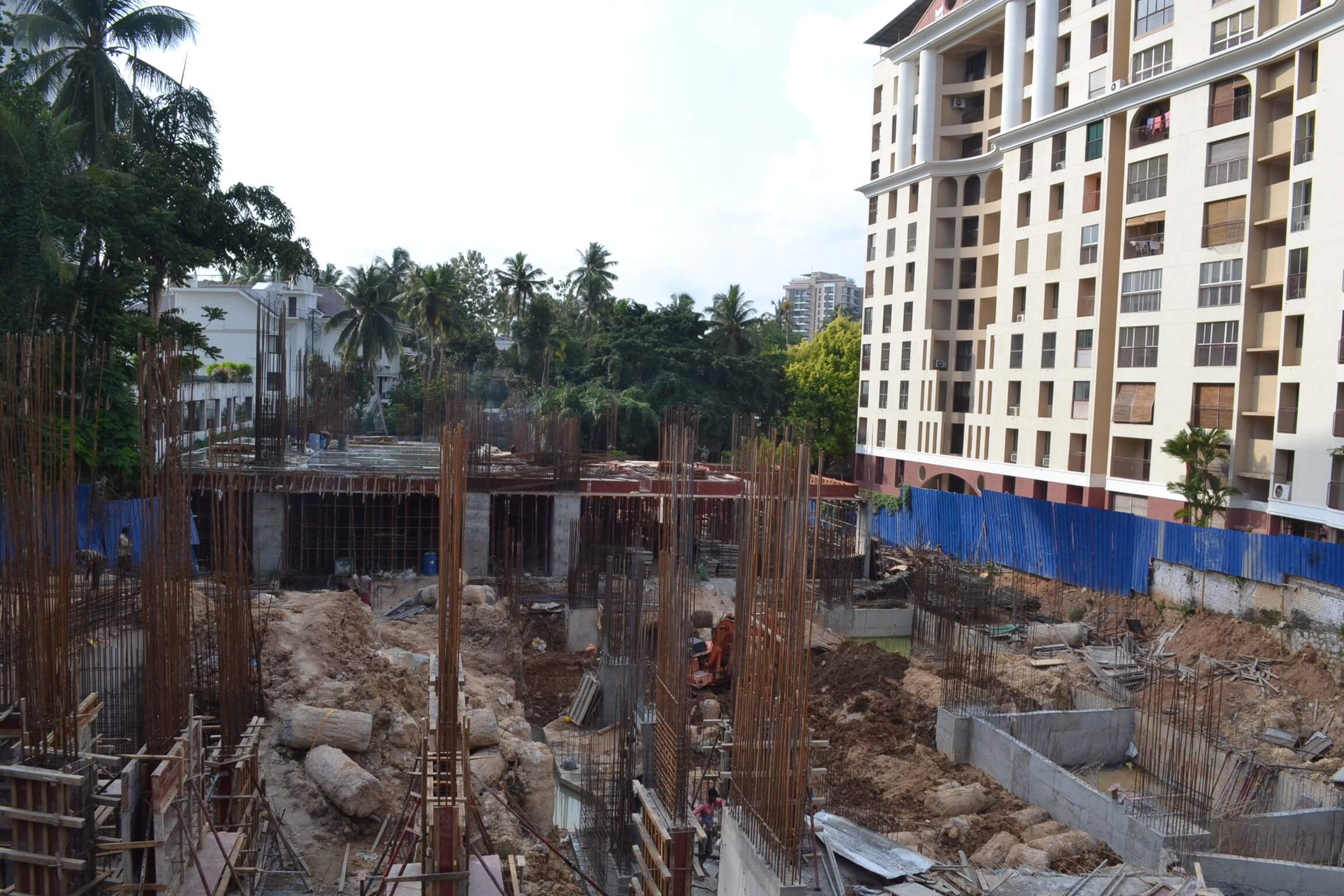

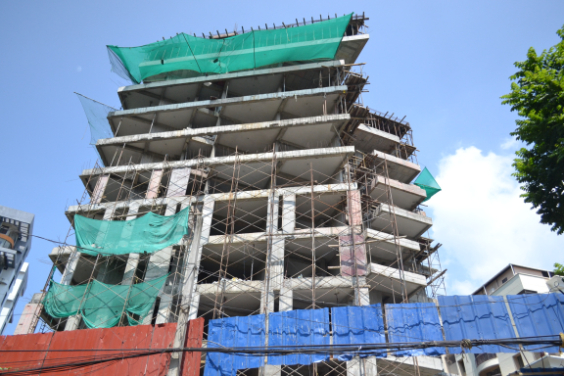

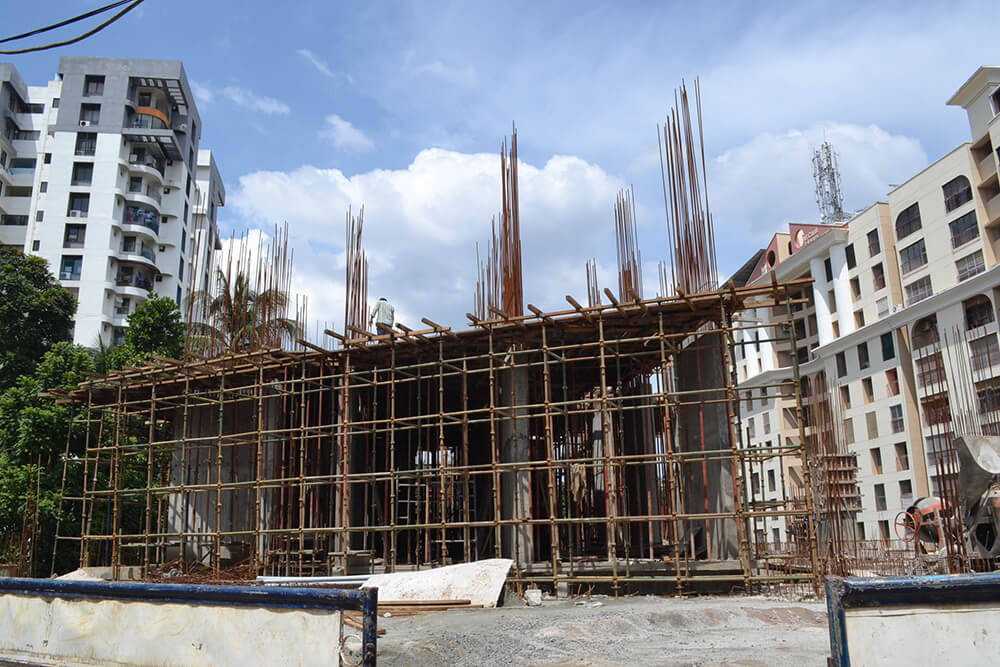

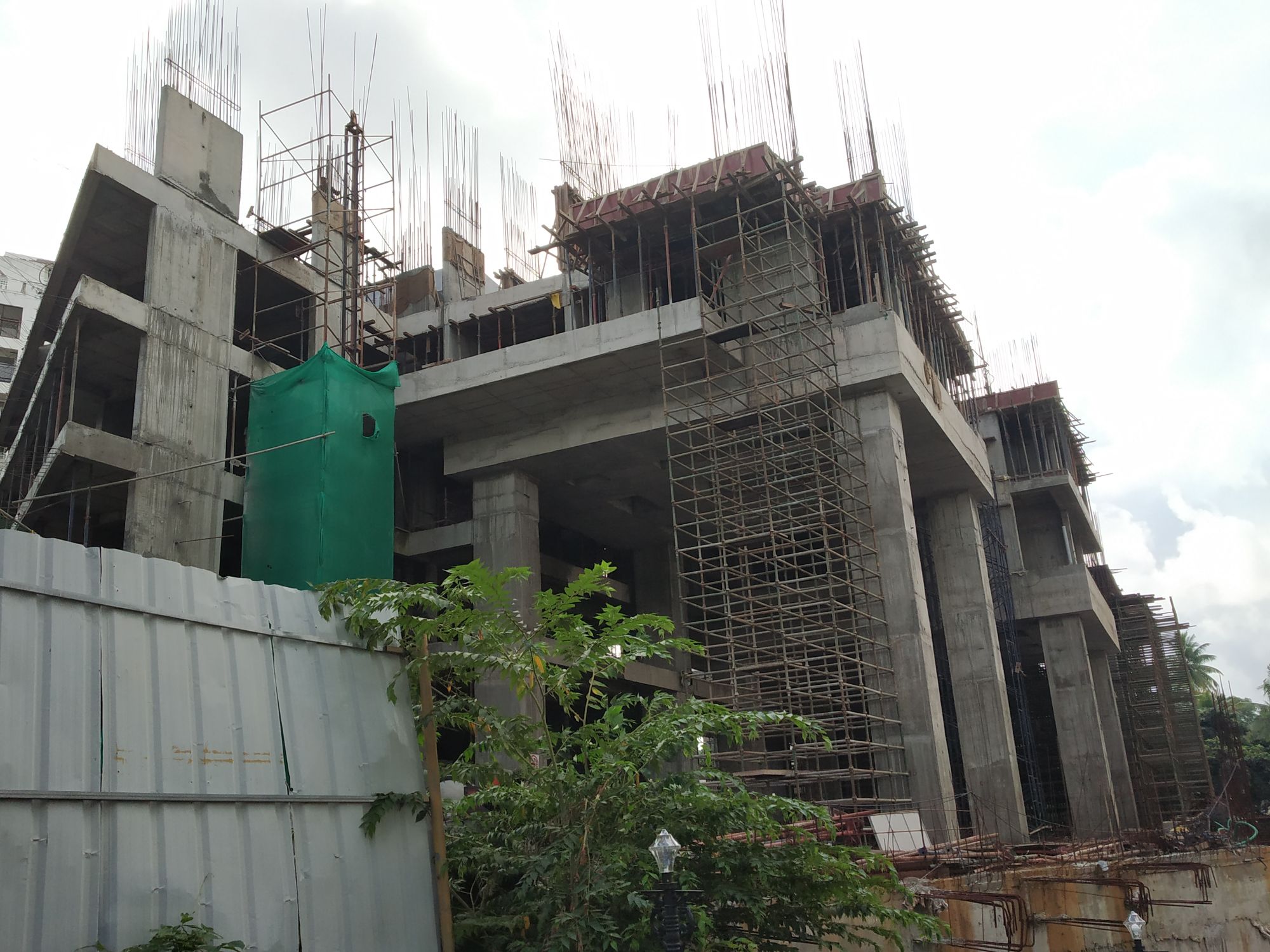

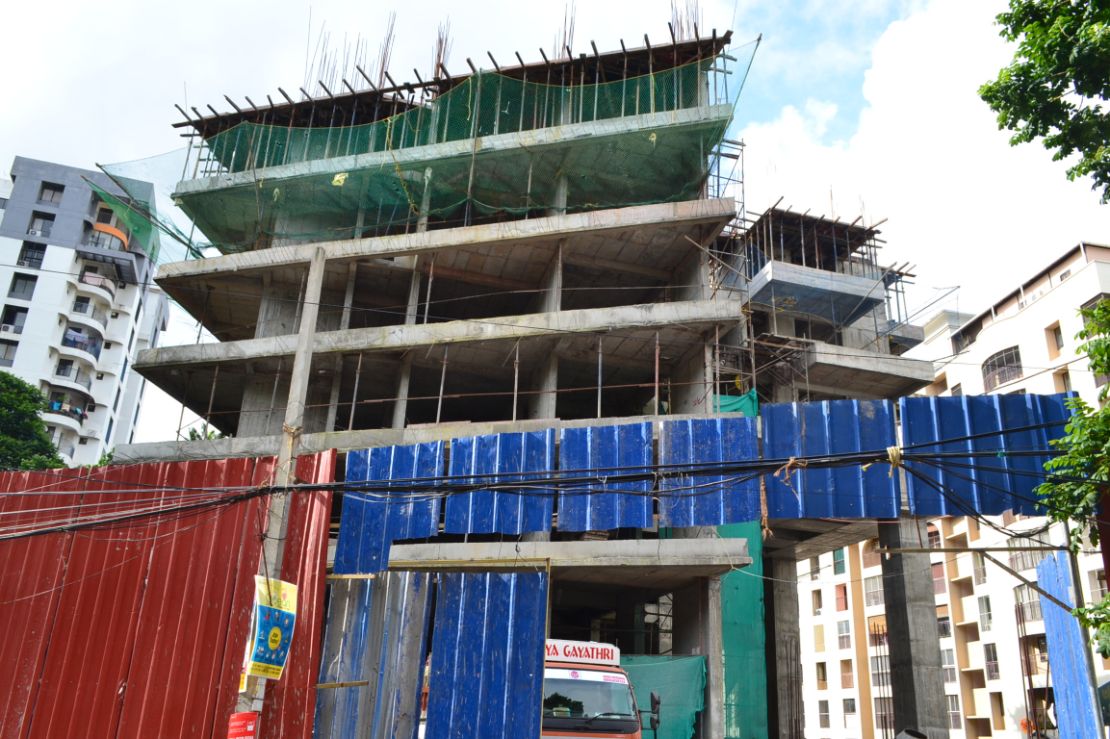

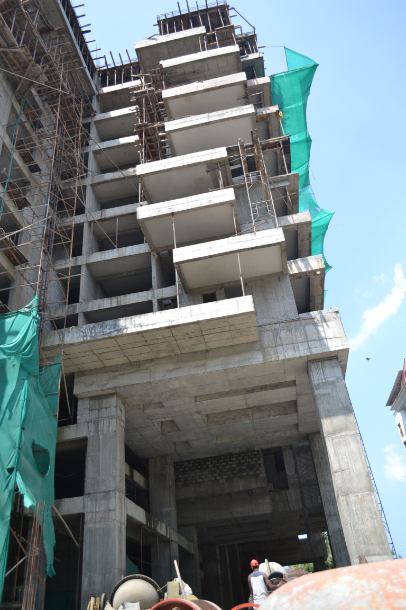

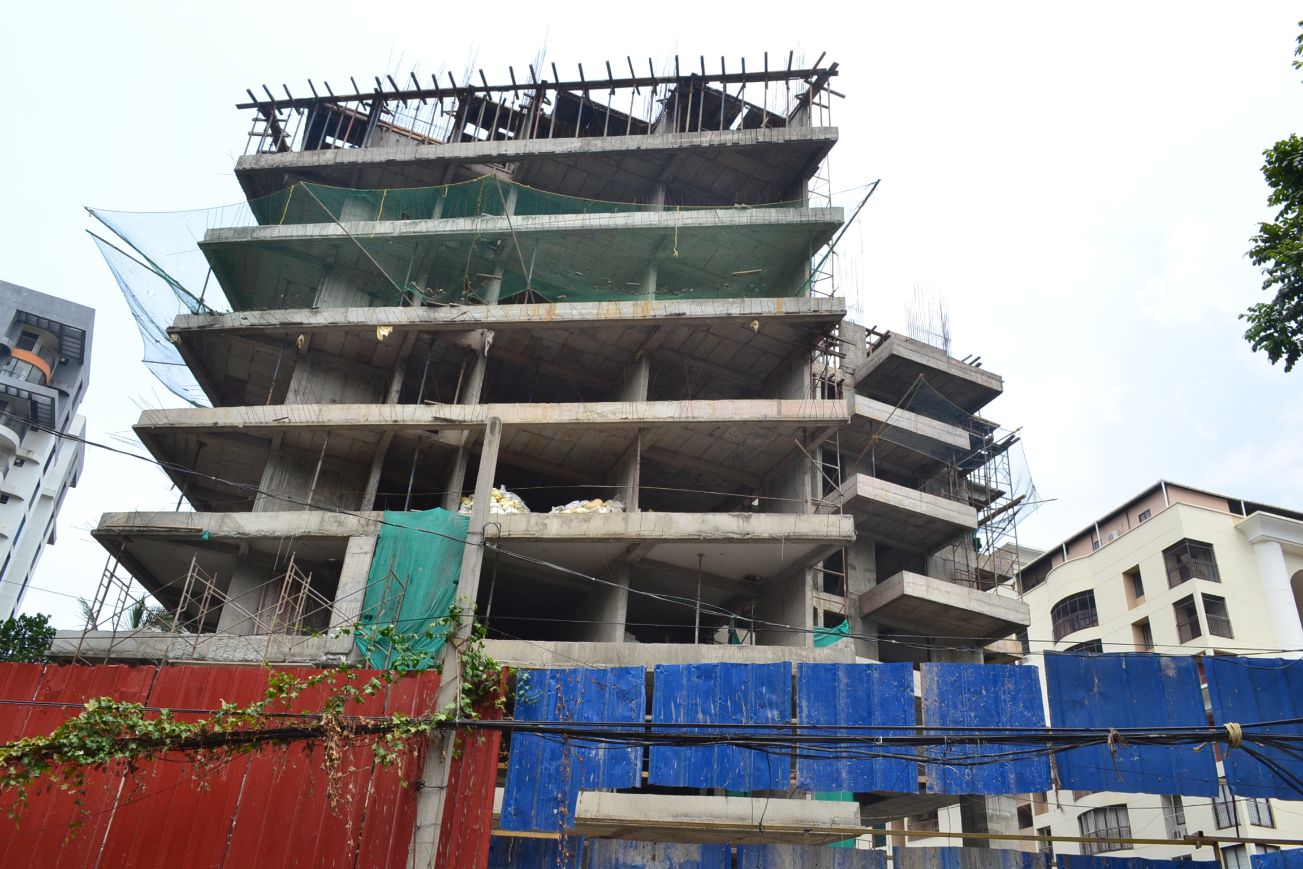

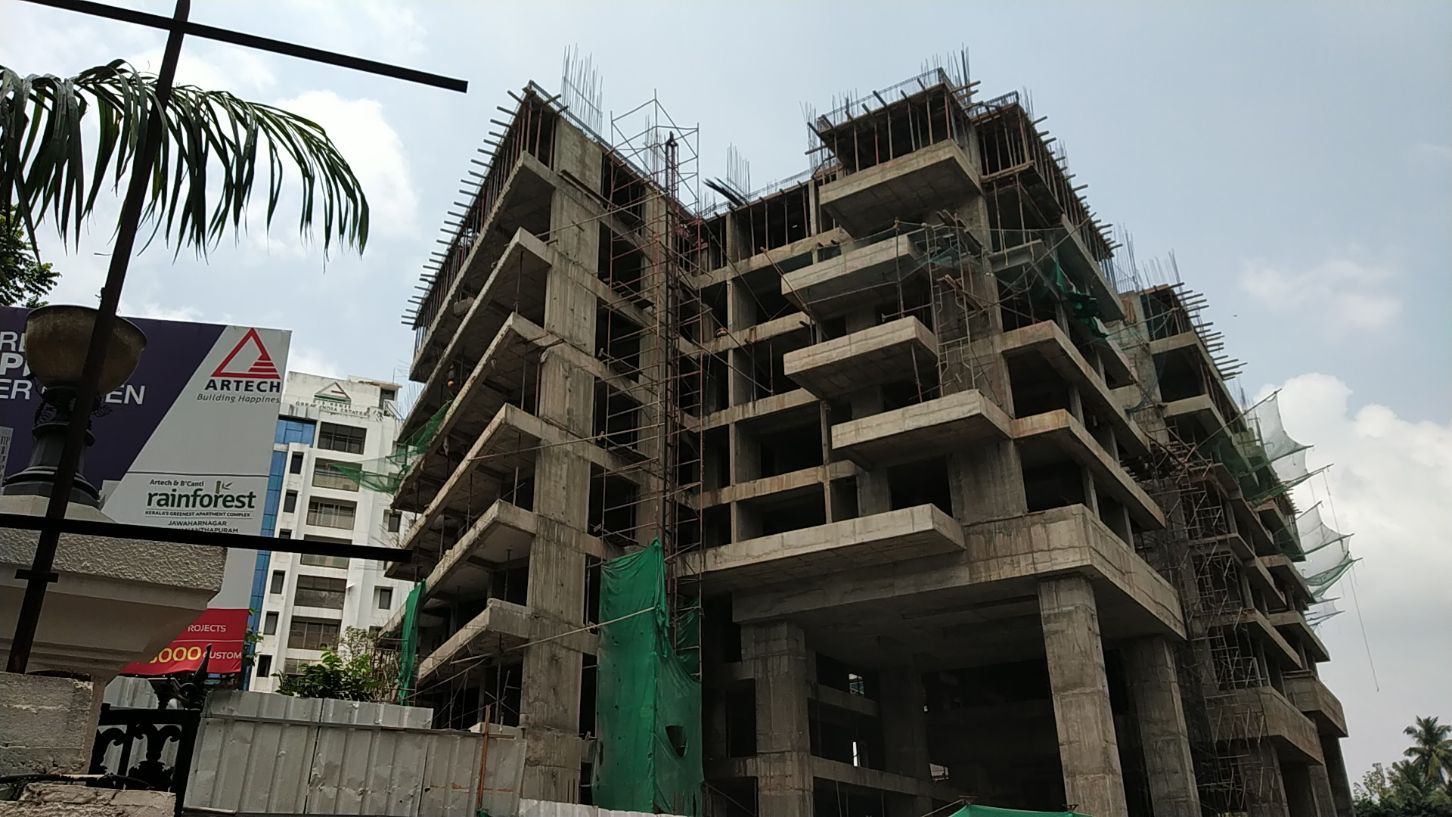

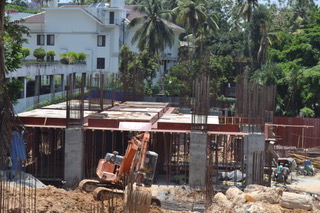

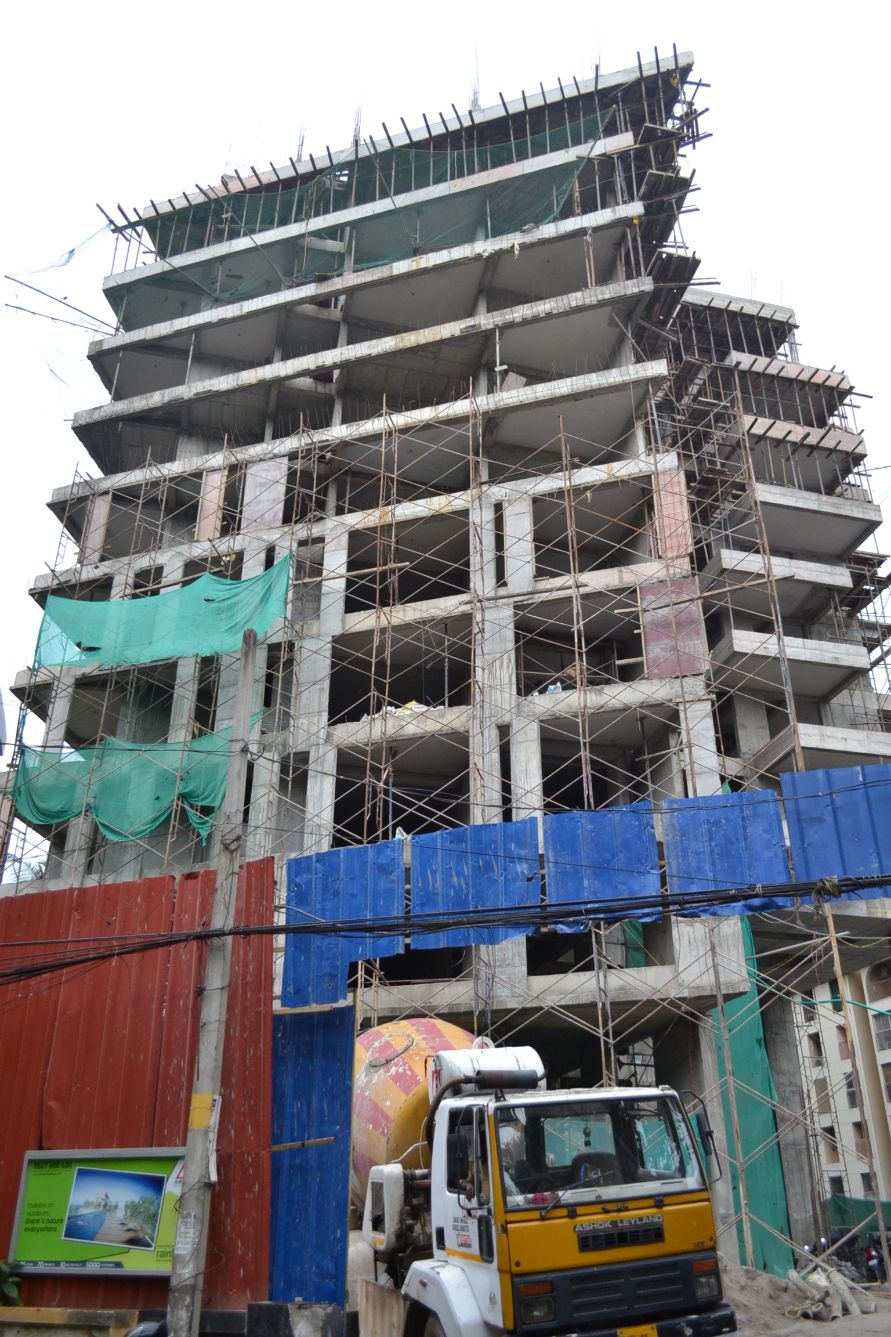

We are pleased to inform you the current work progress at our site Artech “RAINFOREST”, Jawahar nagar Trivandrum. Few snaps of the work progress attached for your reference.

            • Piling work – 100% completed
            • Earth work – 85% completed
            • Pile chipping work – 295 nos completed (out of 323)
            • Grade slab work – 80% completed
            • RCC for slab – BF roof slab – 15% completed

As per the current work status from our site we are targeted to complete the following works by end of April 2018

            • Earth work – 100% to be completed
            • Pile chipping work – 310 nos to be completed (out of 323)
            • Pile cap work – 65 nos to be completed (out of 72)
            • Grade slab work – 100% to be completed
            • RCC for slab – BF- 20% to be completed

Work status as on 16-04-2018, we have completed the following.

            • Piling work – 100% completed
            • Earth work – 75% completed
            • Pile chipping work – 270 nos completed (out of 323)
            • Pile cap work – 54 nos completed (out of 72)
            • Grade slab work – 60% completed
            • RCC for slab – BF roof slab – progressing

As per the current work status from our site we are targeted to complete the following works by end of March 2018

            • Earth work – 100% to be completed
            • Pile chipping work – 280 nos to be completed (out of 323)
            • Pile cap work – 45 nos to be completed (out of 72)
            • Grade slab work – 100% to be completed
            • Piling work -134 to be completed (out of 174)

Work status as on 10-03-2018, we have completed the following.

            • Piling work – 100% completed
            • Earth work – 70% completed
            • Pile chipping work – 240 nos completed (out of 323)
            • Pile cap work – 39 nos completed (out of 72)
            • Grade slab work – 40% completed

As per the current work progress from our site we are progressing with the same and will complete it by the end of February 2018

            • Earth work – 60% to be completed
            • Pile chipping work – 234 nos to be completed (out of 323)
            • Pile cap work – 37 nos to be completed (out of 72)
            • Piling work -107 to be completed (out of 174)

Work status as on 09-02-2018, we have completed the following.

            • Piling work – 100% completed
            • Earth work – 55% completed
            • Pile chipping work – 210 nos completed (out of 323)
            • Pile cap work – 31 nos completed (out of 72)

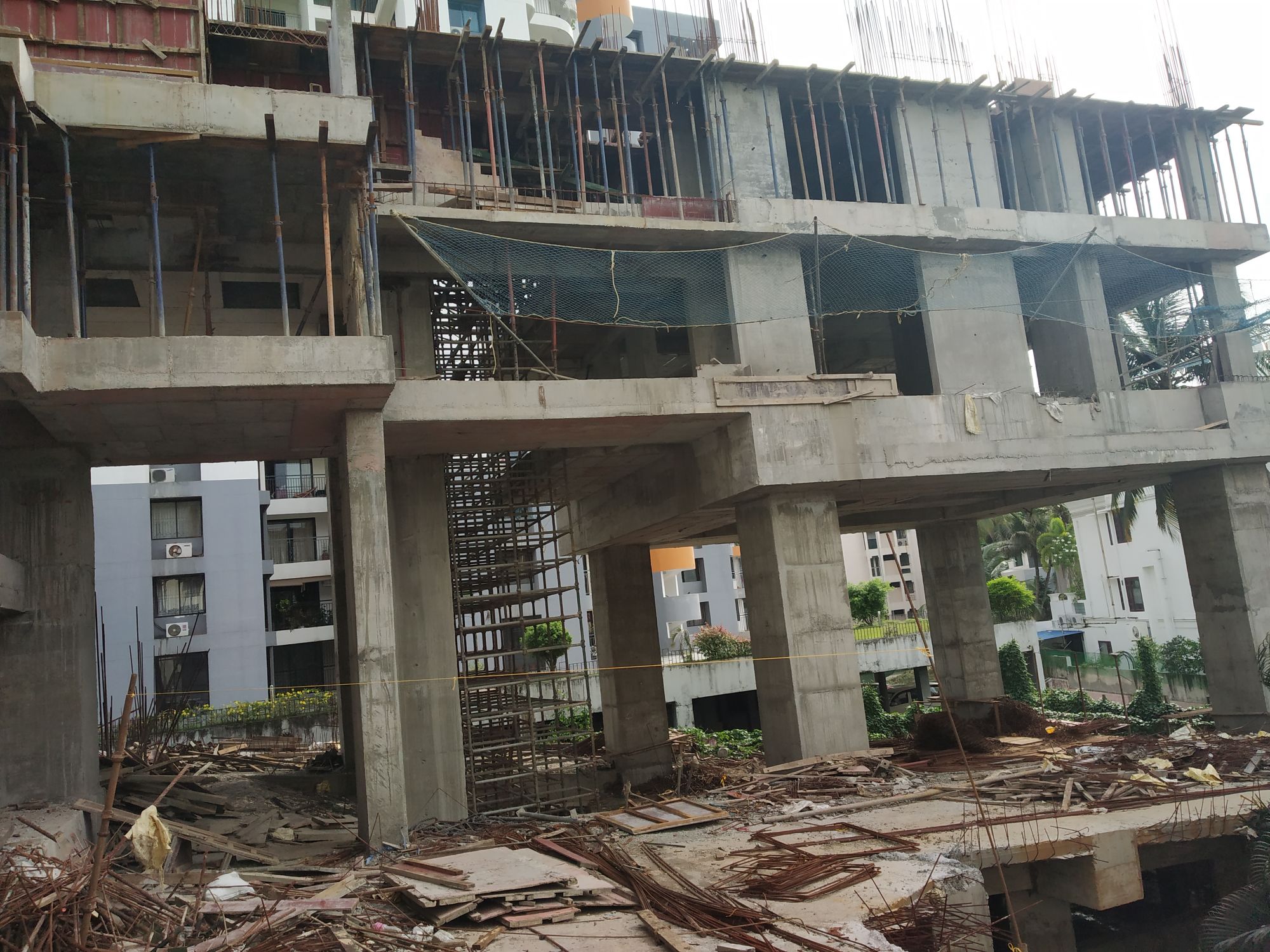

Work status as on 5-7-2017, we have completed.

            • Piling work – progressing

As per the current work progress from our site we are progressing with the same and will complete it by the end of JULY, 2017

Work status as on 9-5-2017, we have completed.
