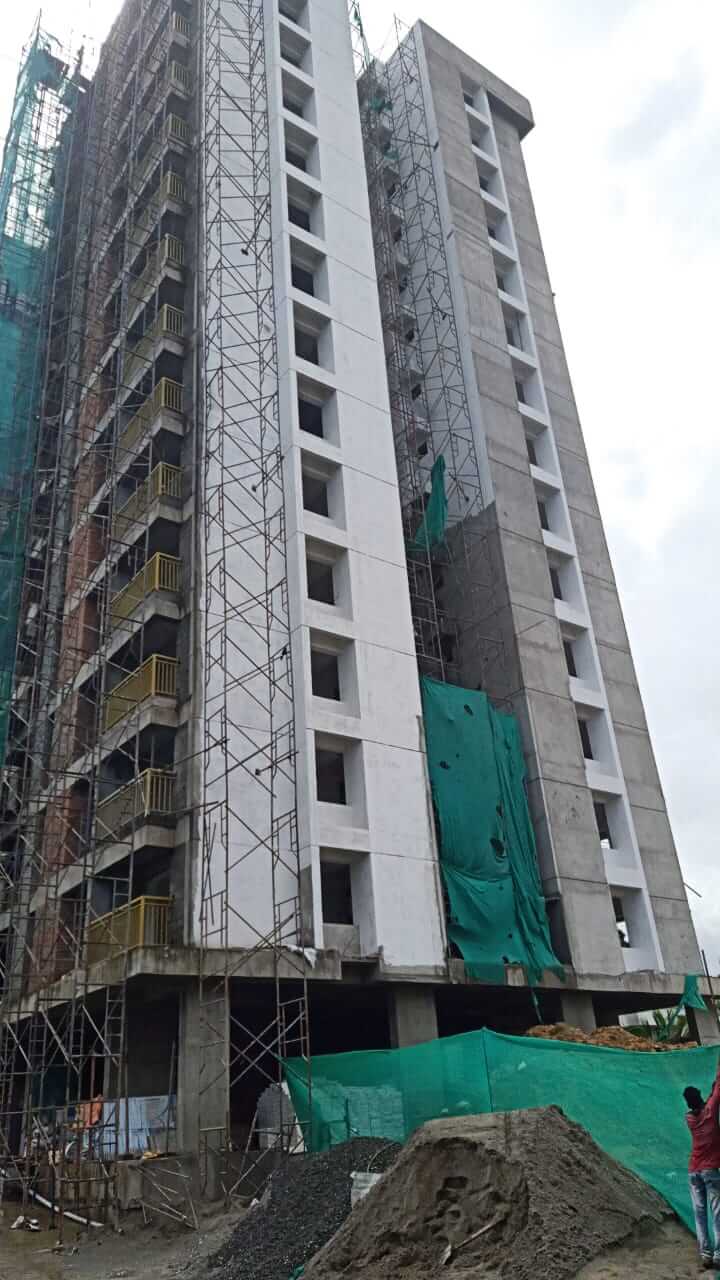

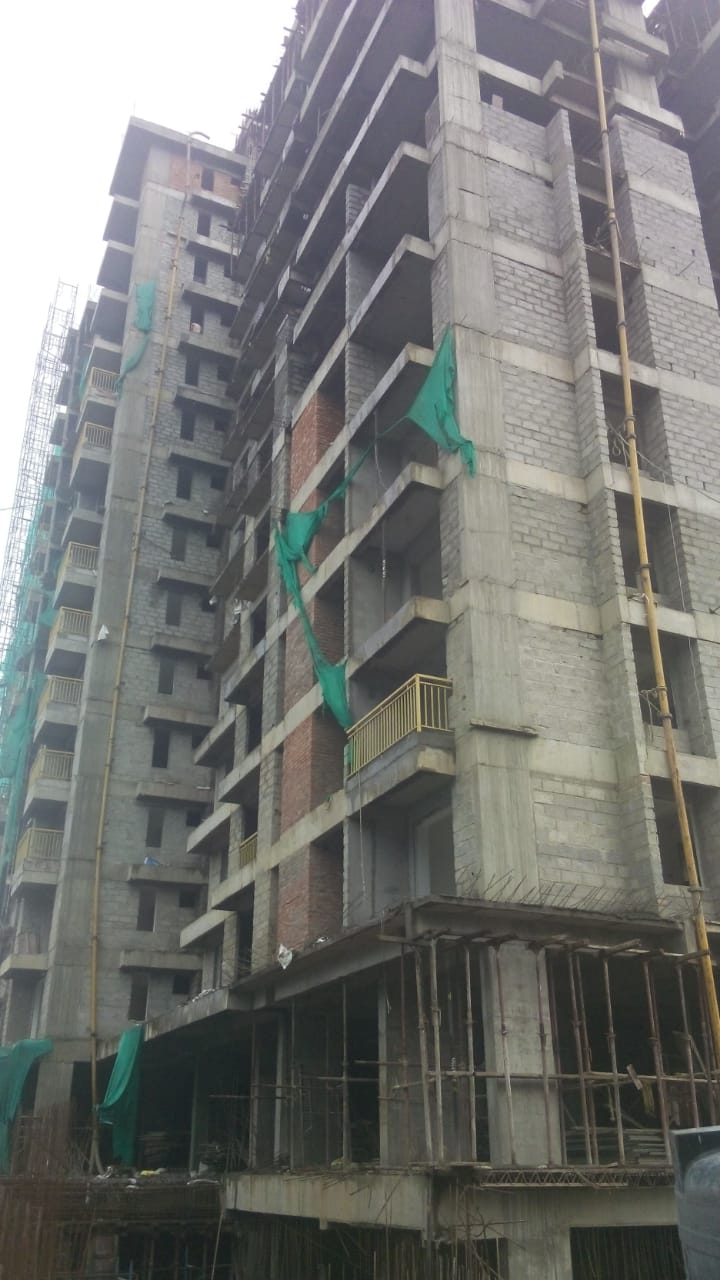

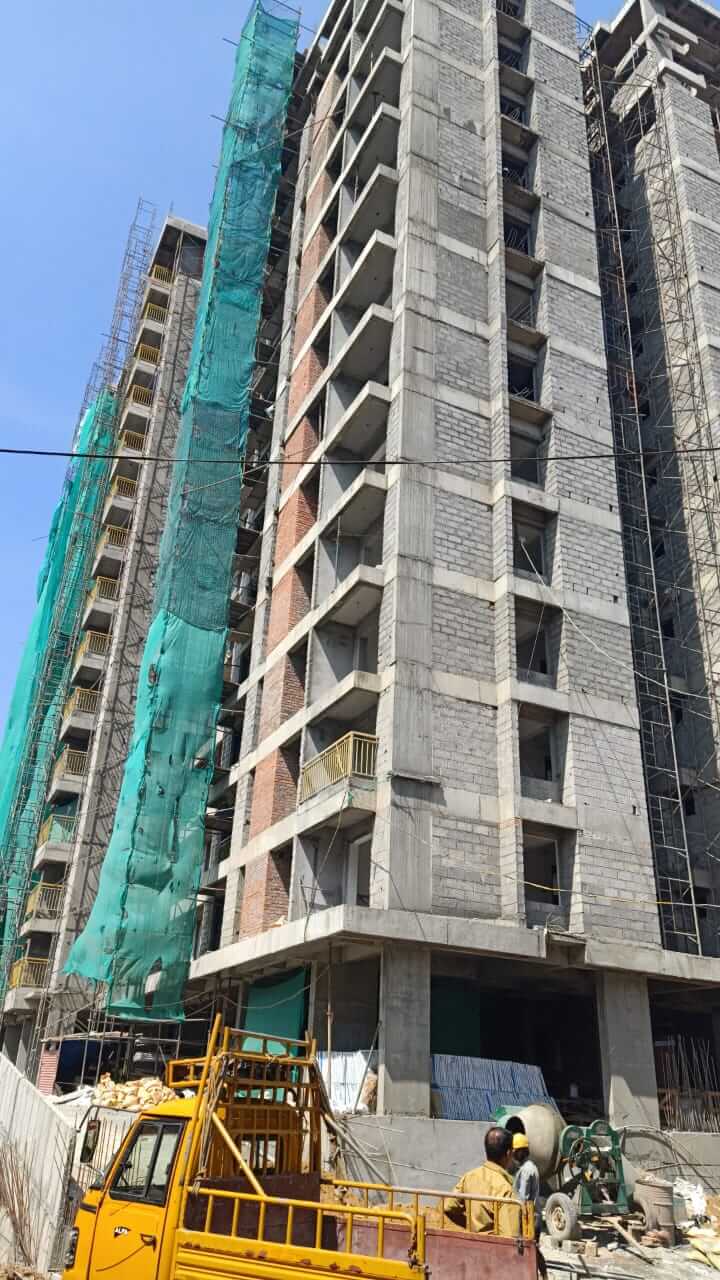

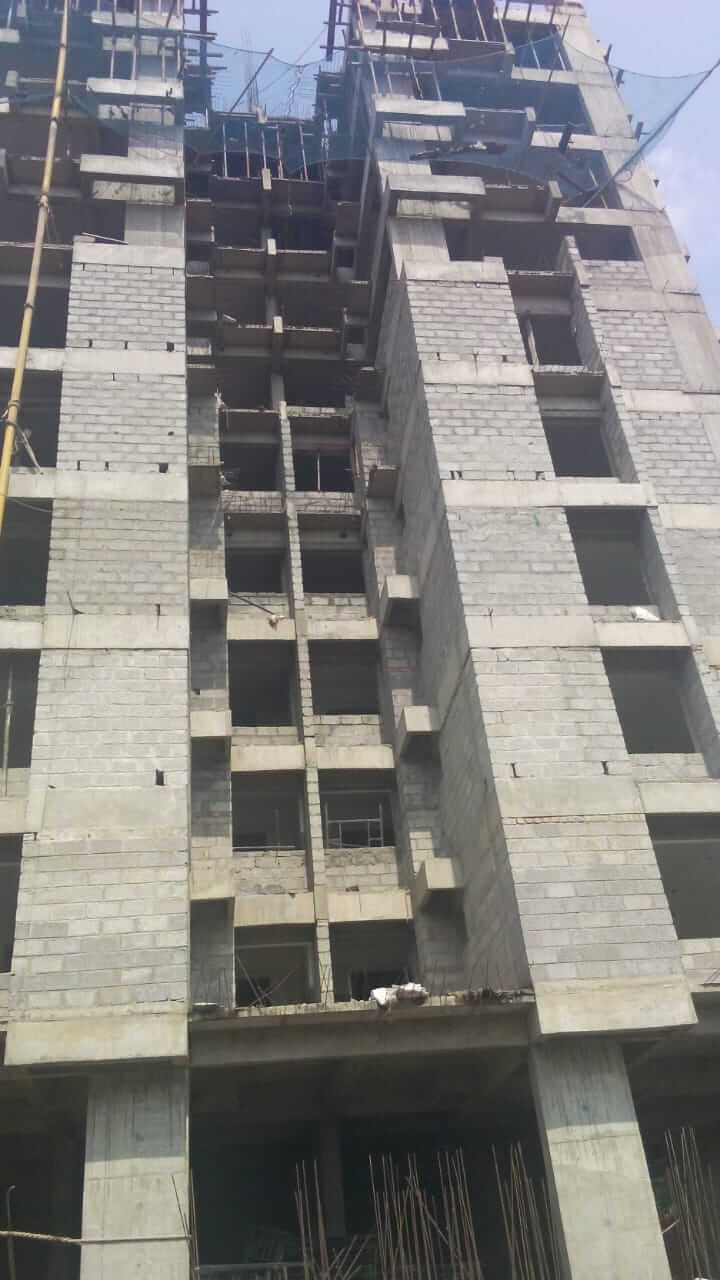

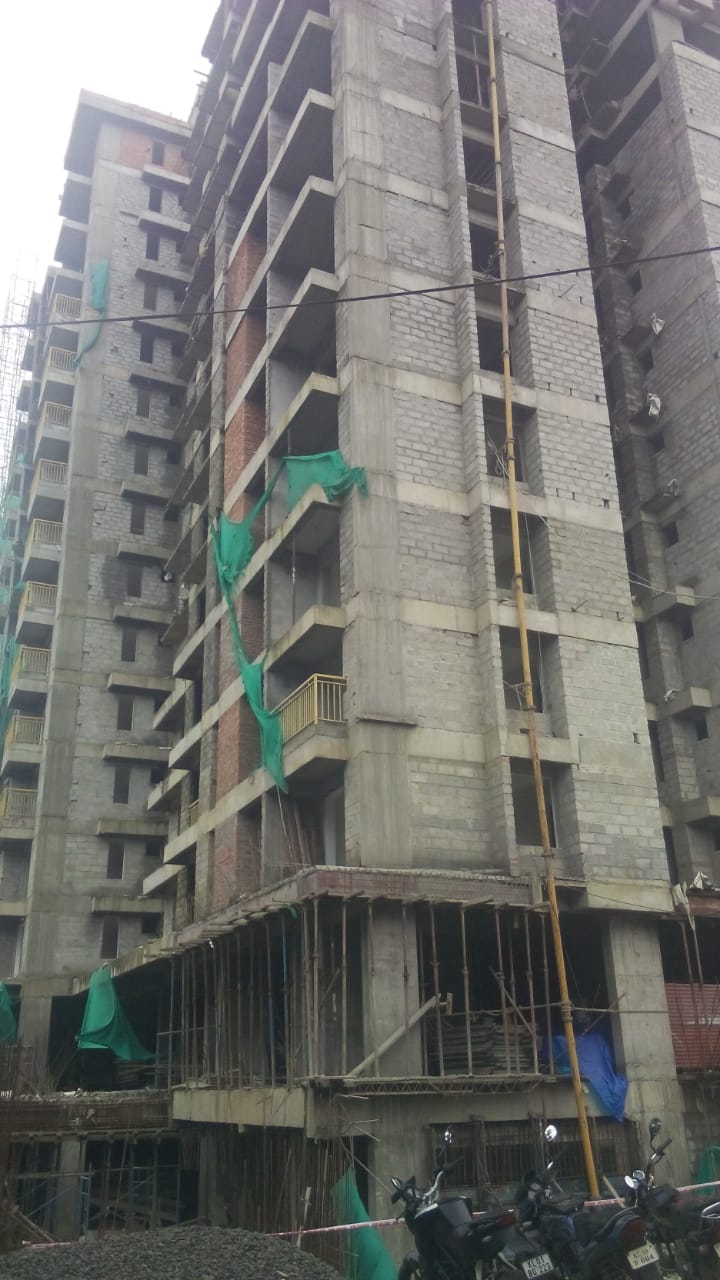

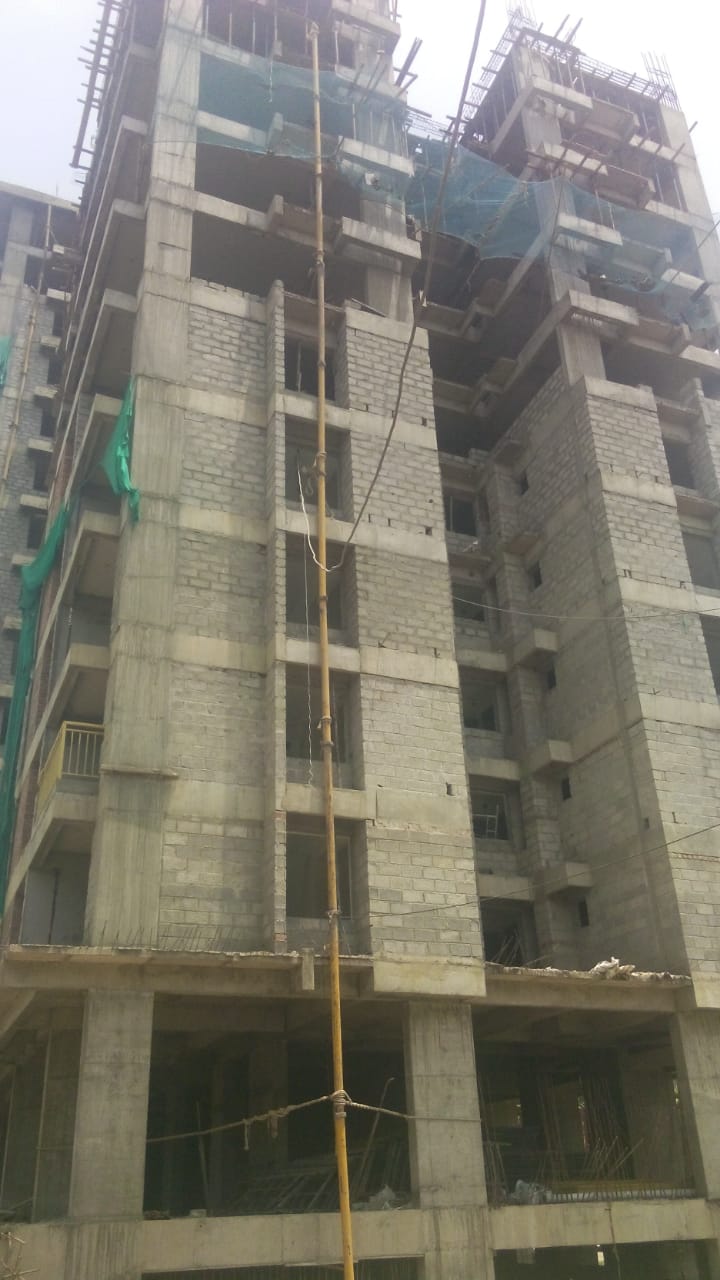

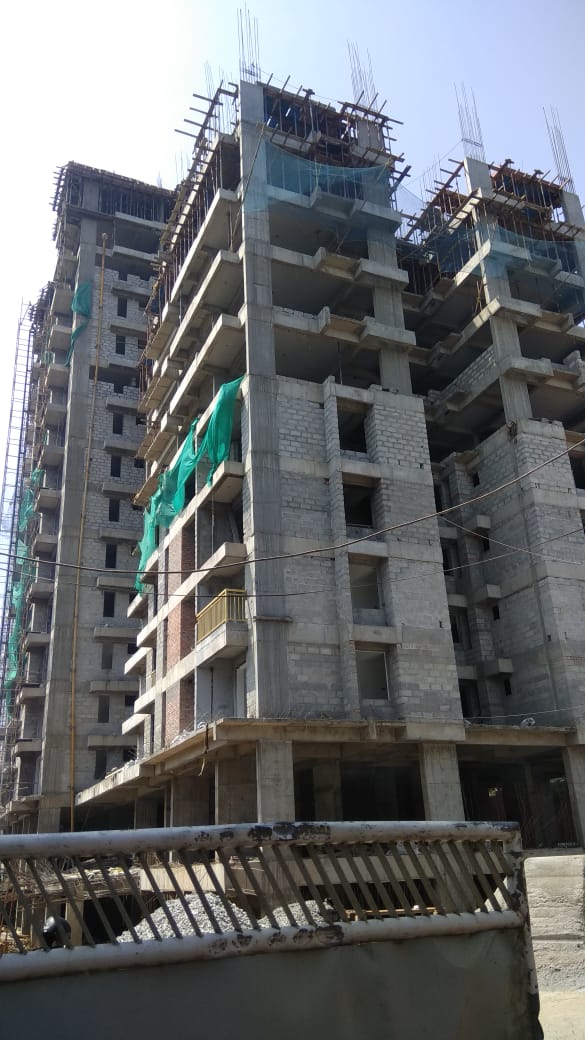

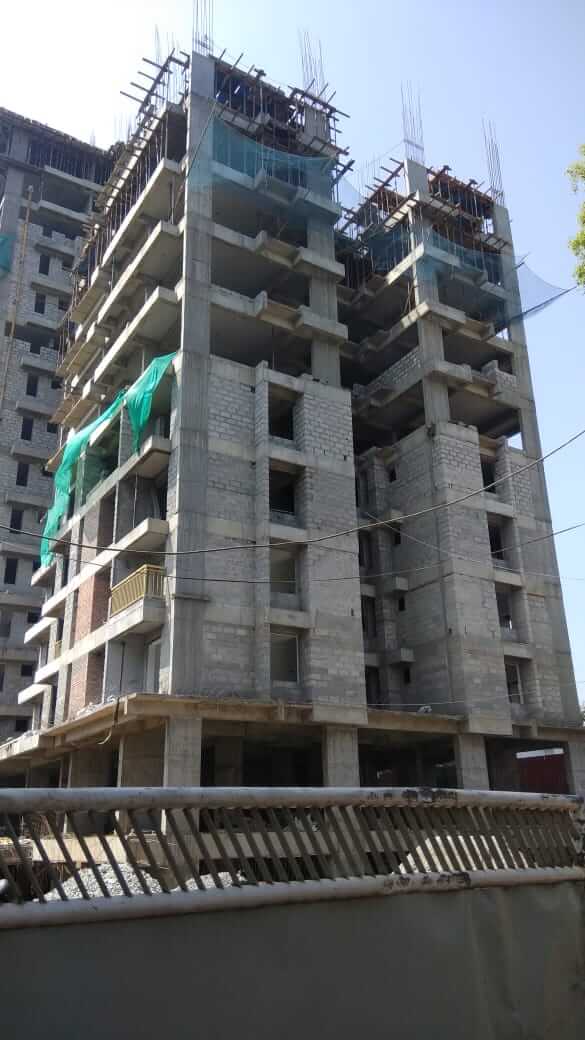

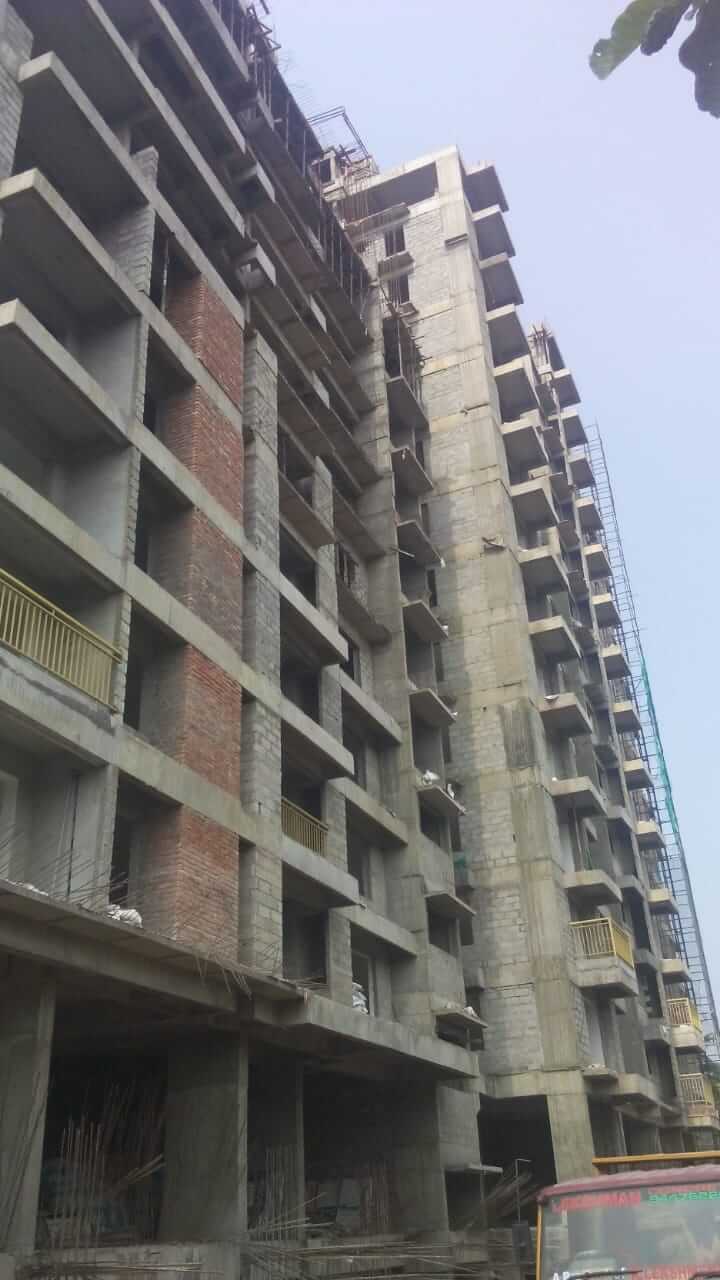

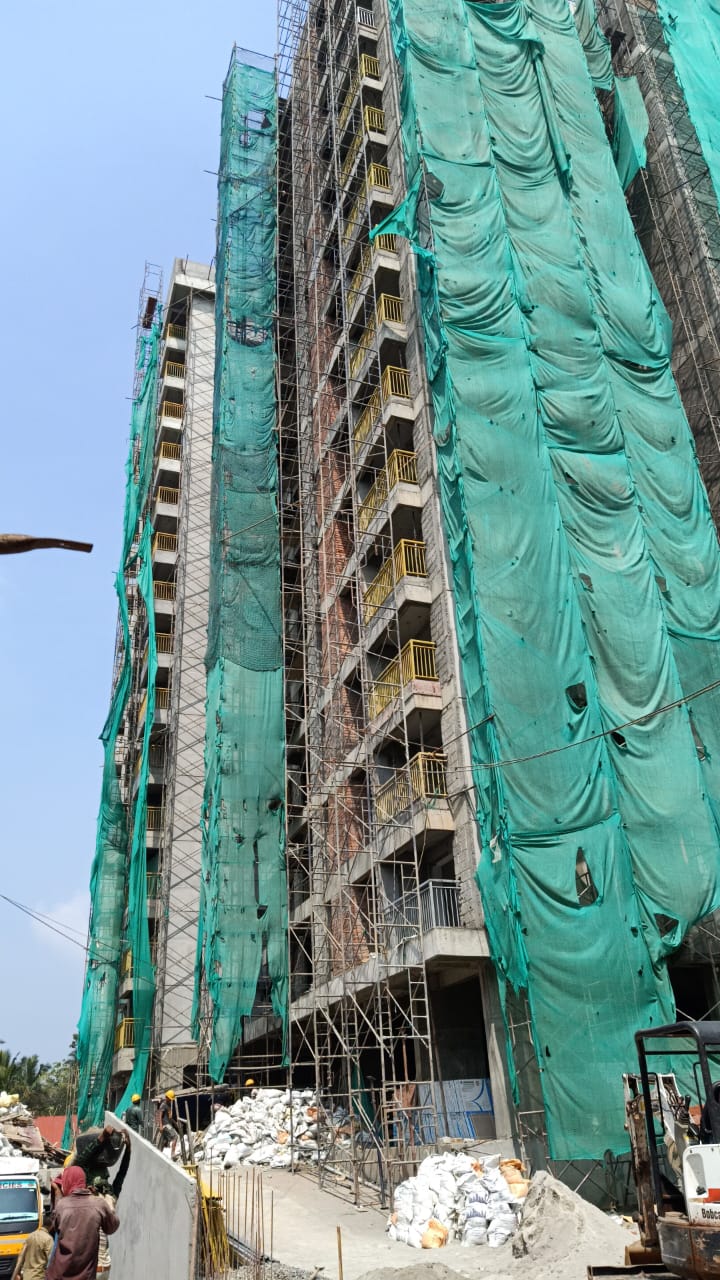

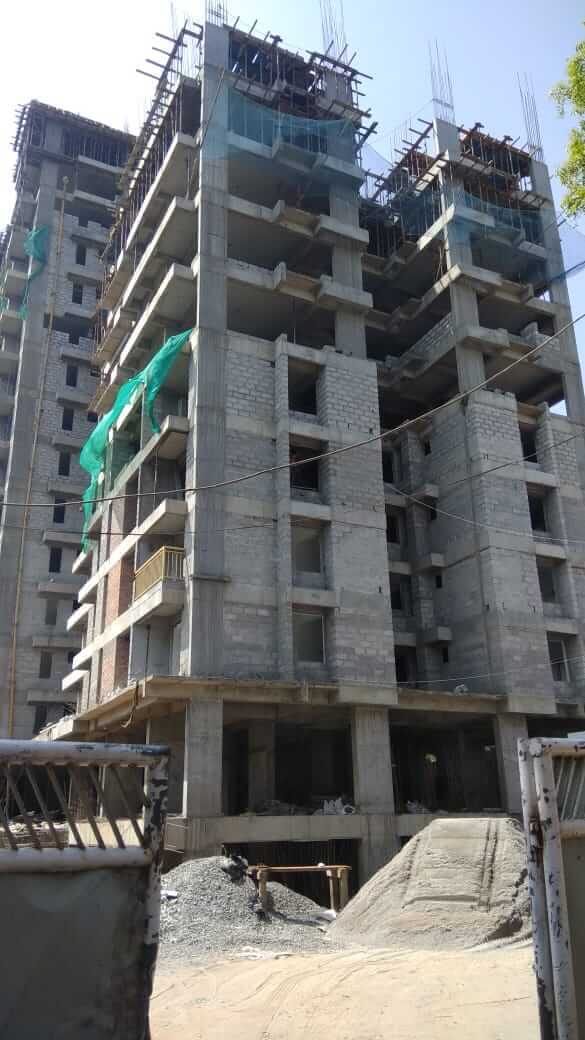

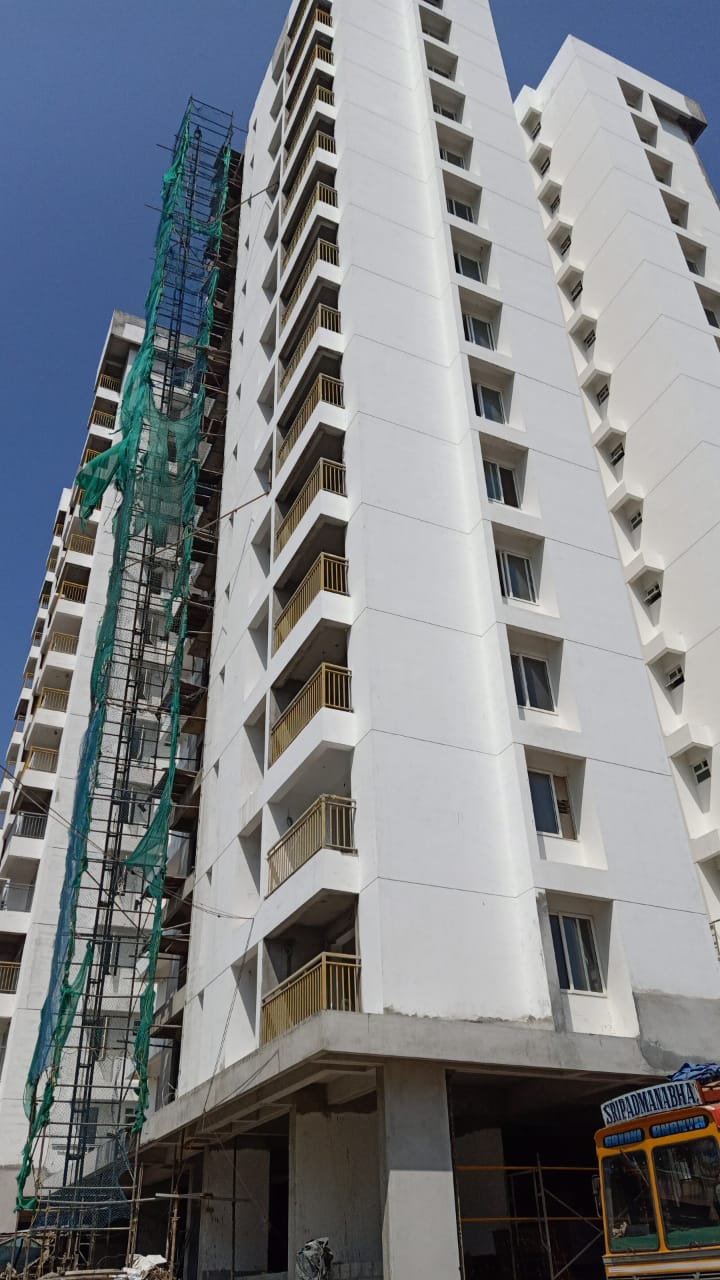

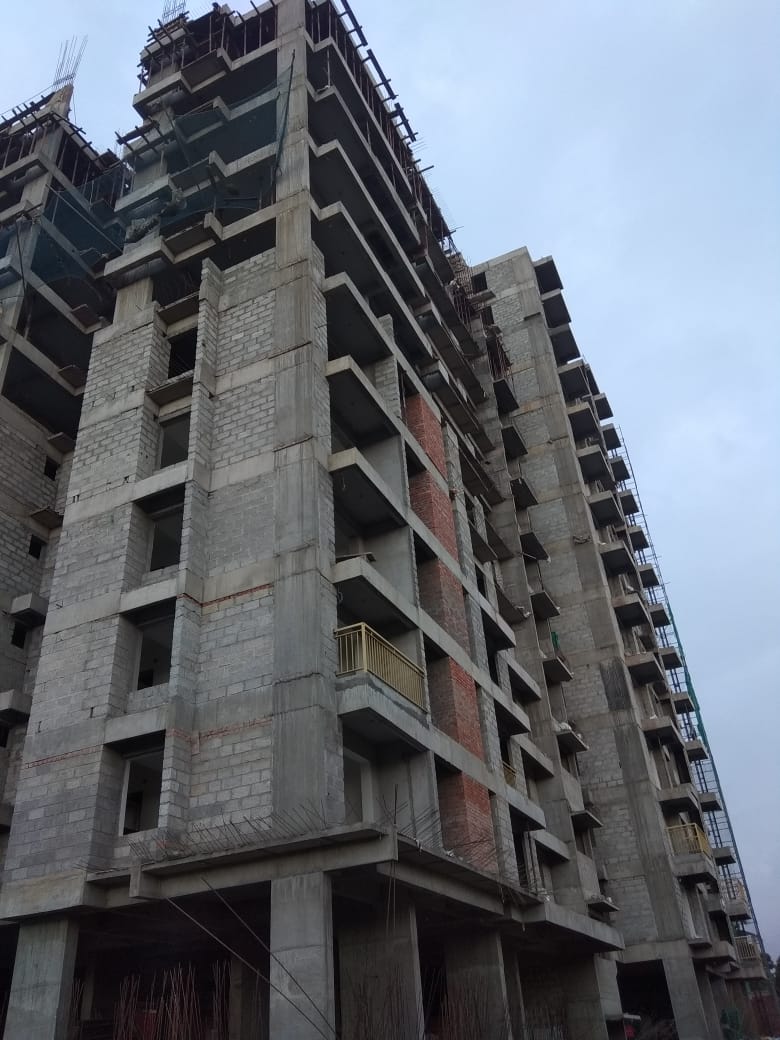

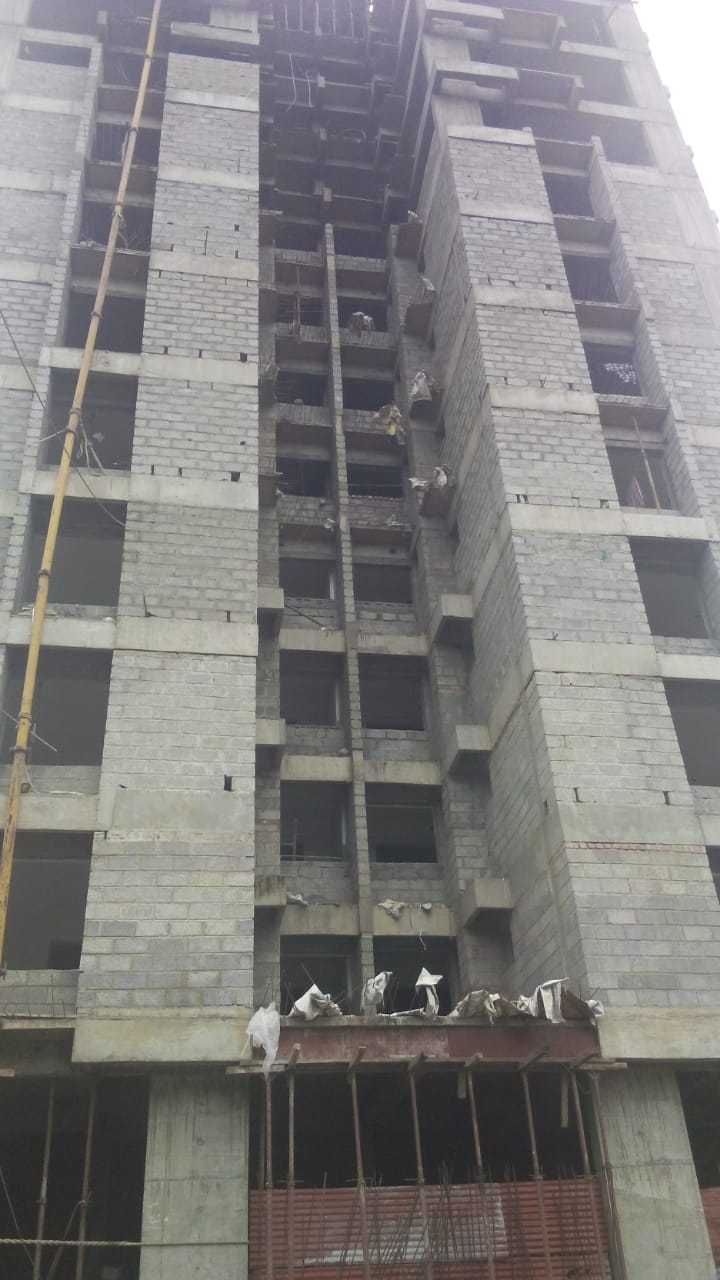

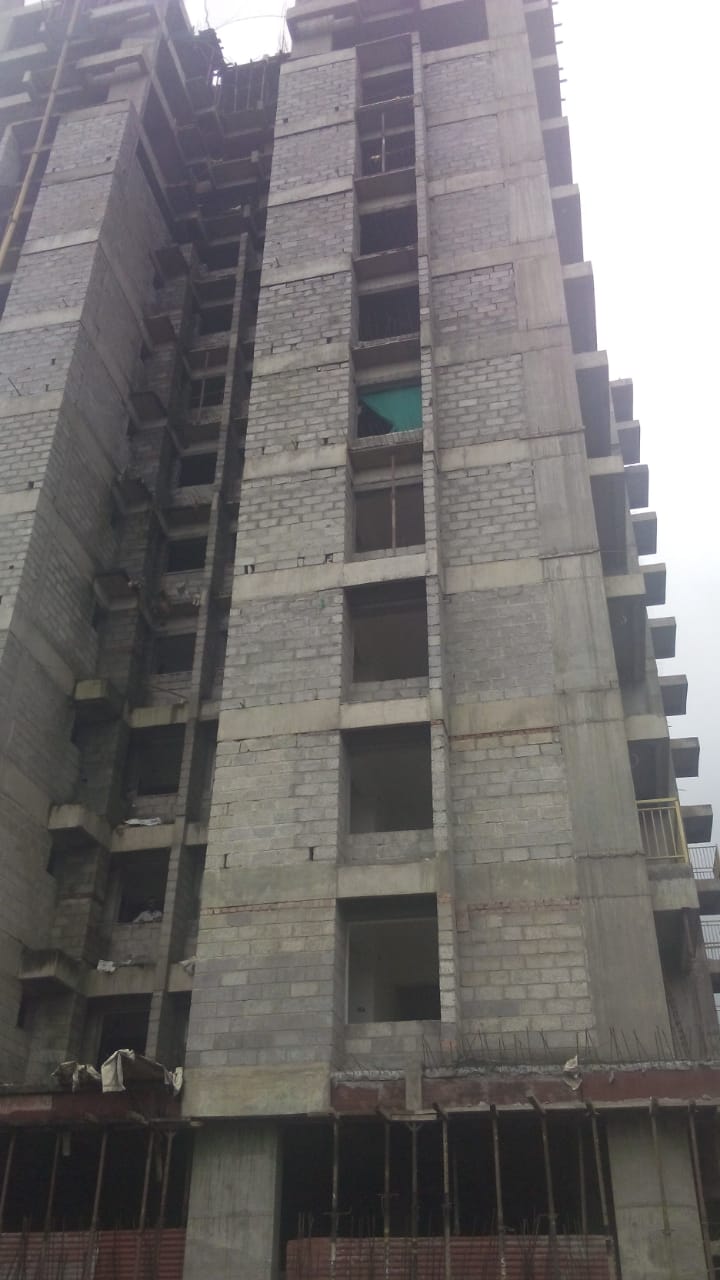

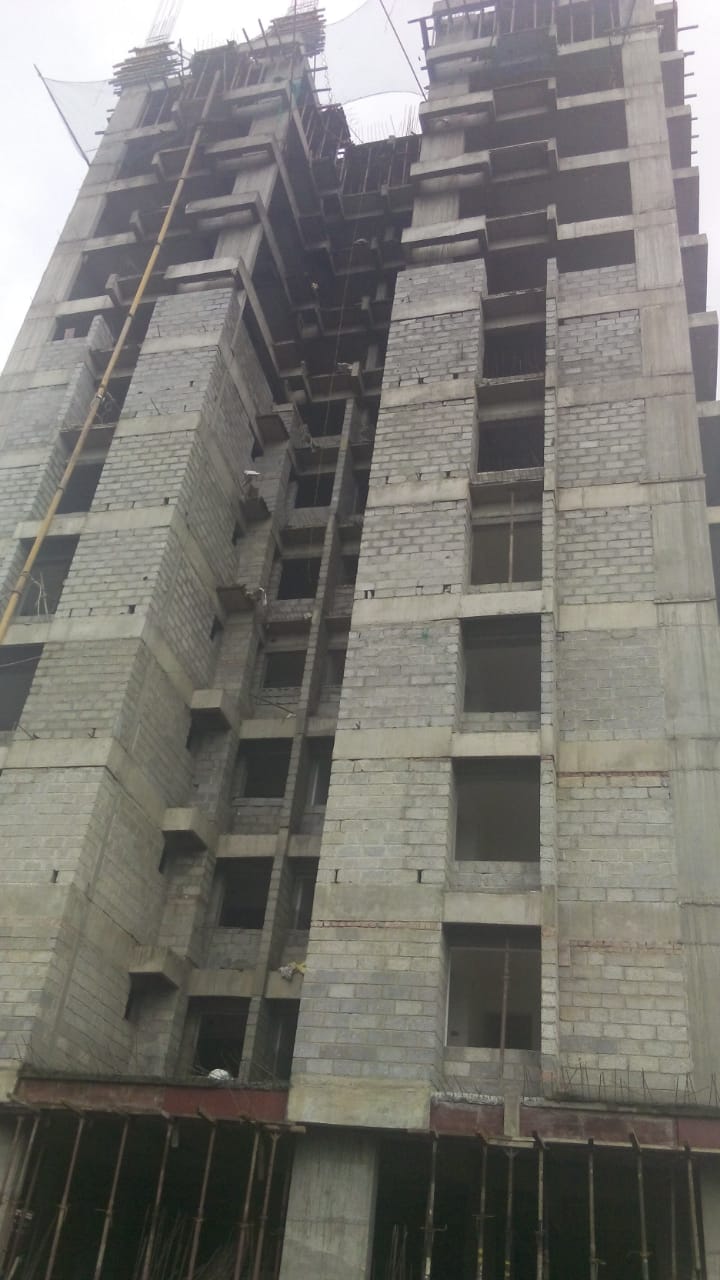

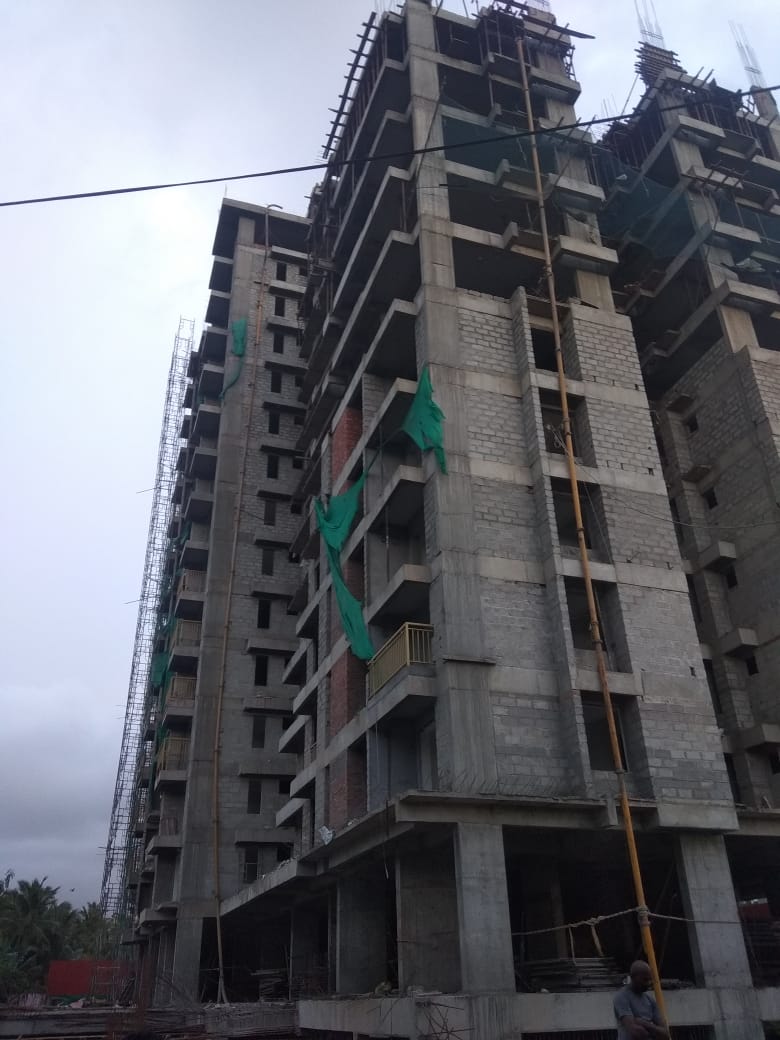

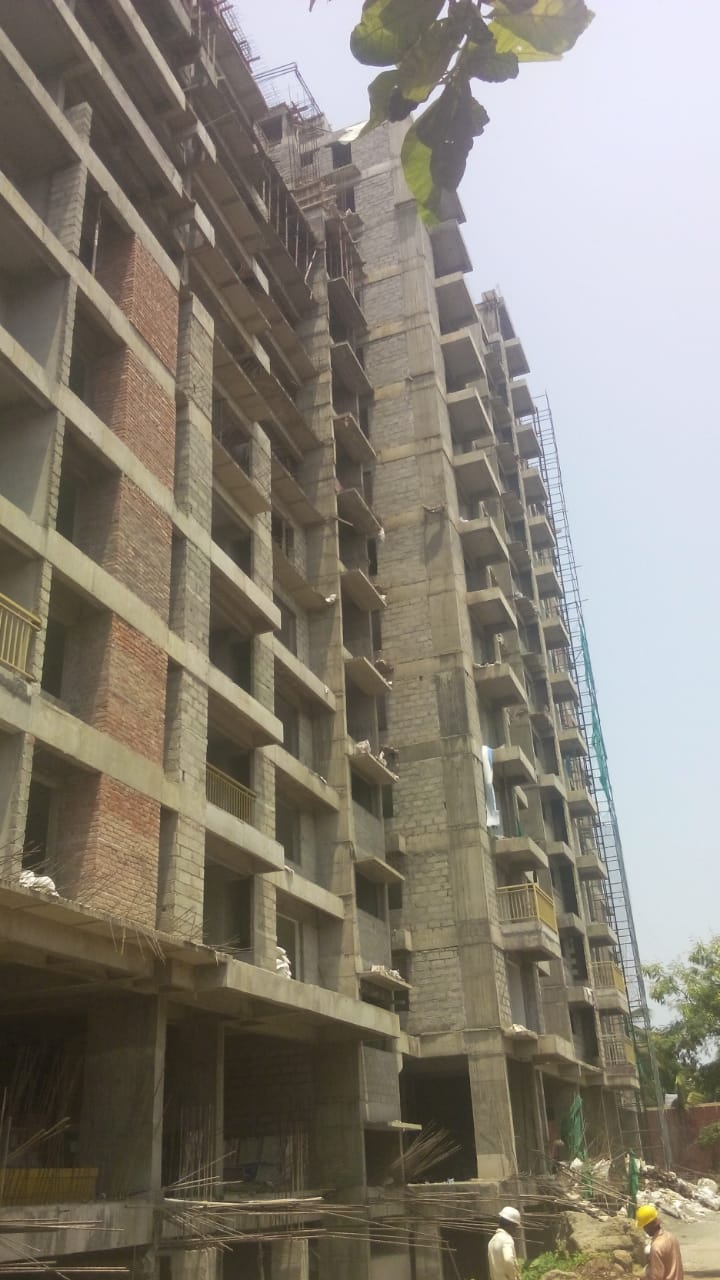

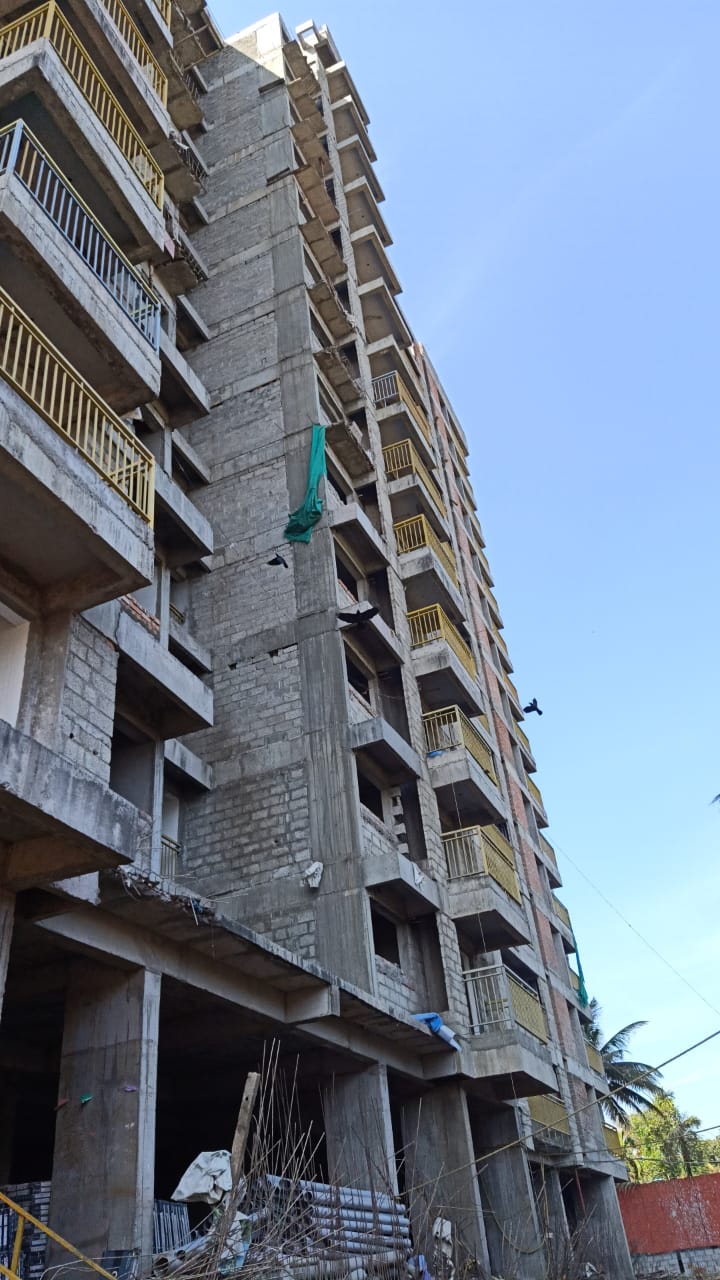

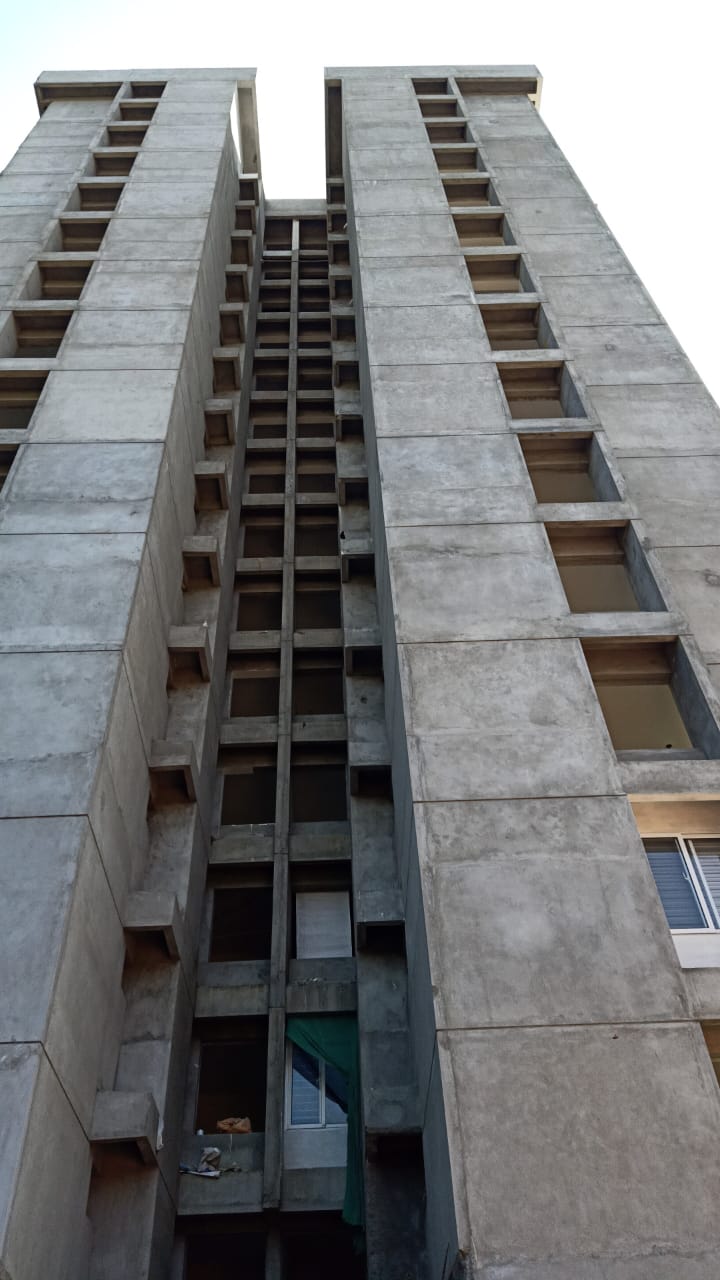

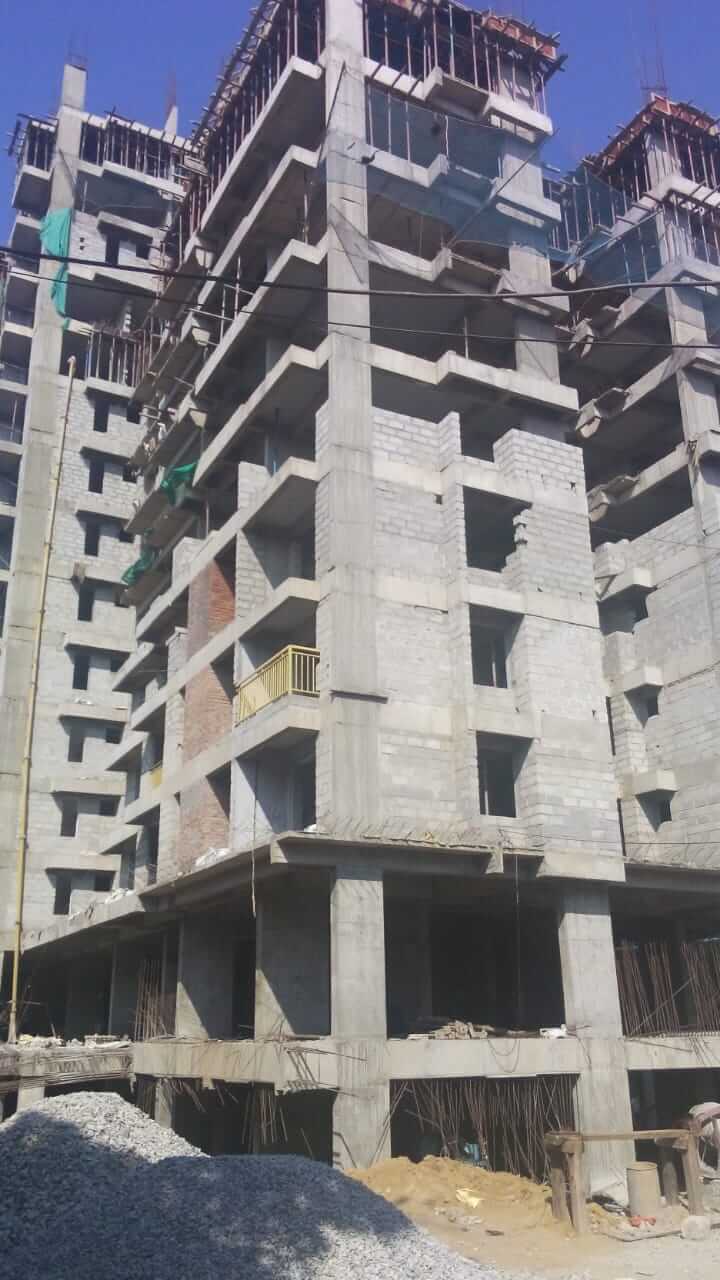

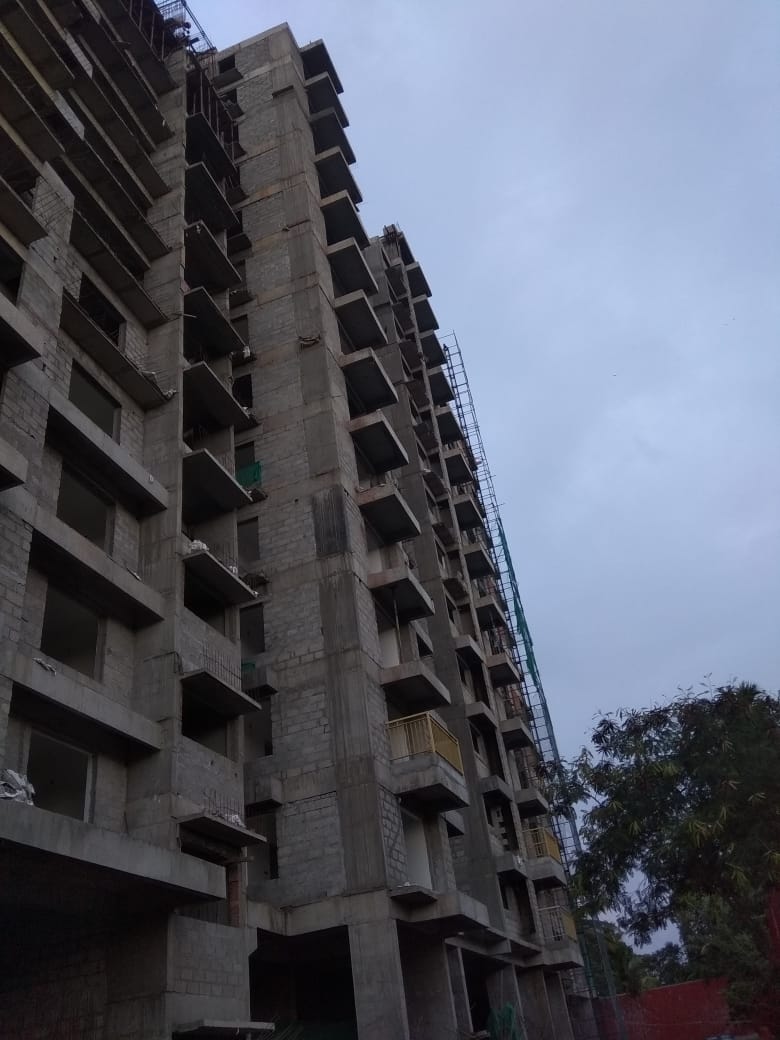

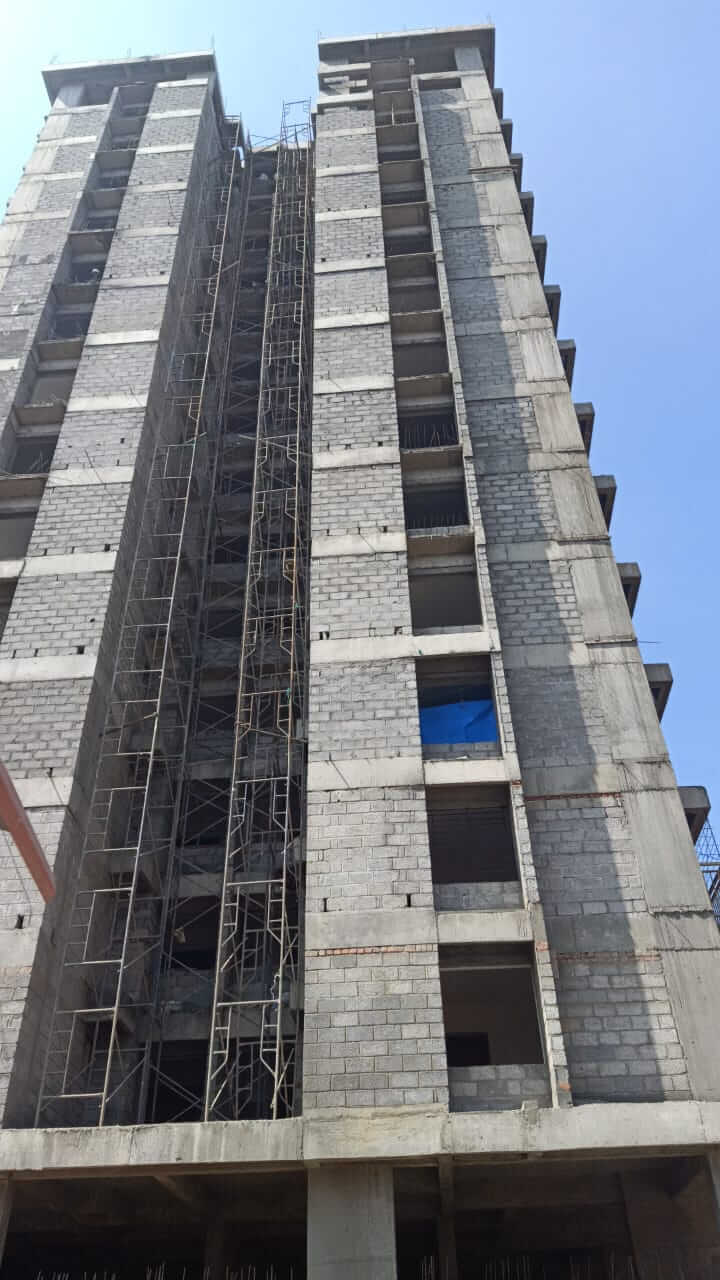

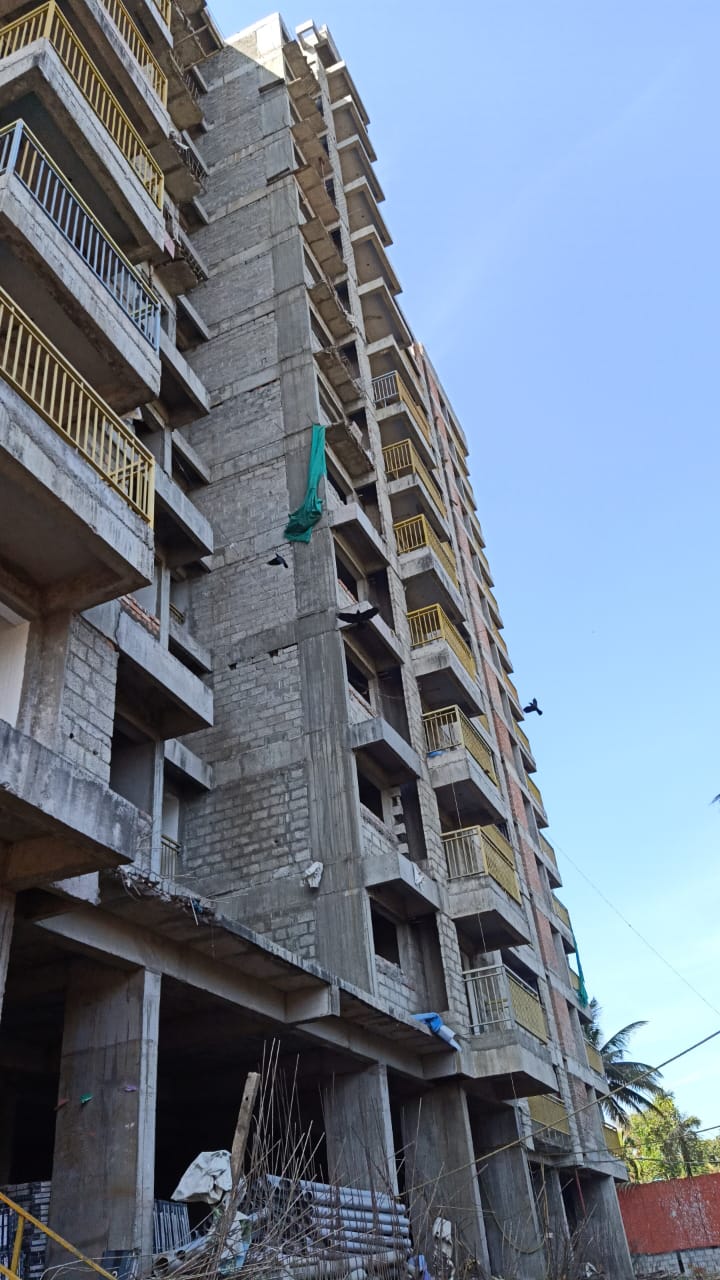

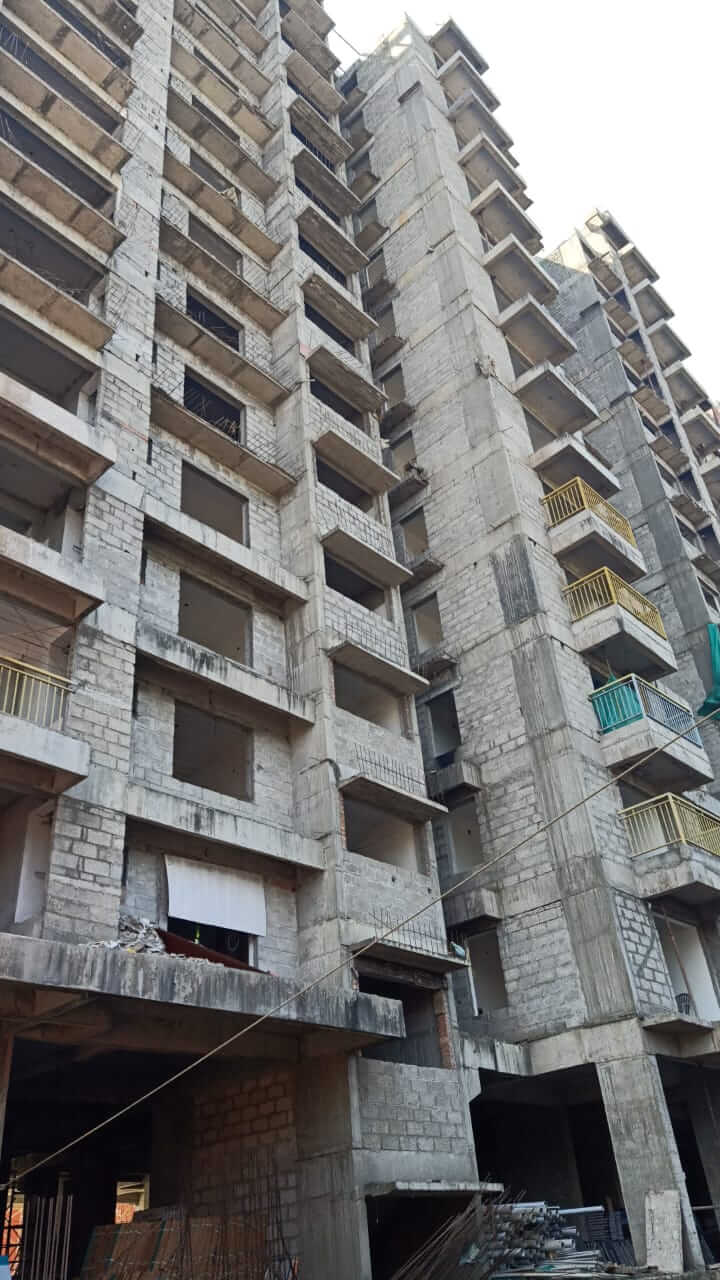

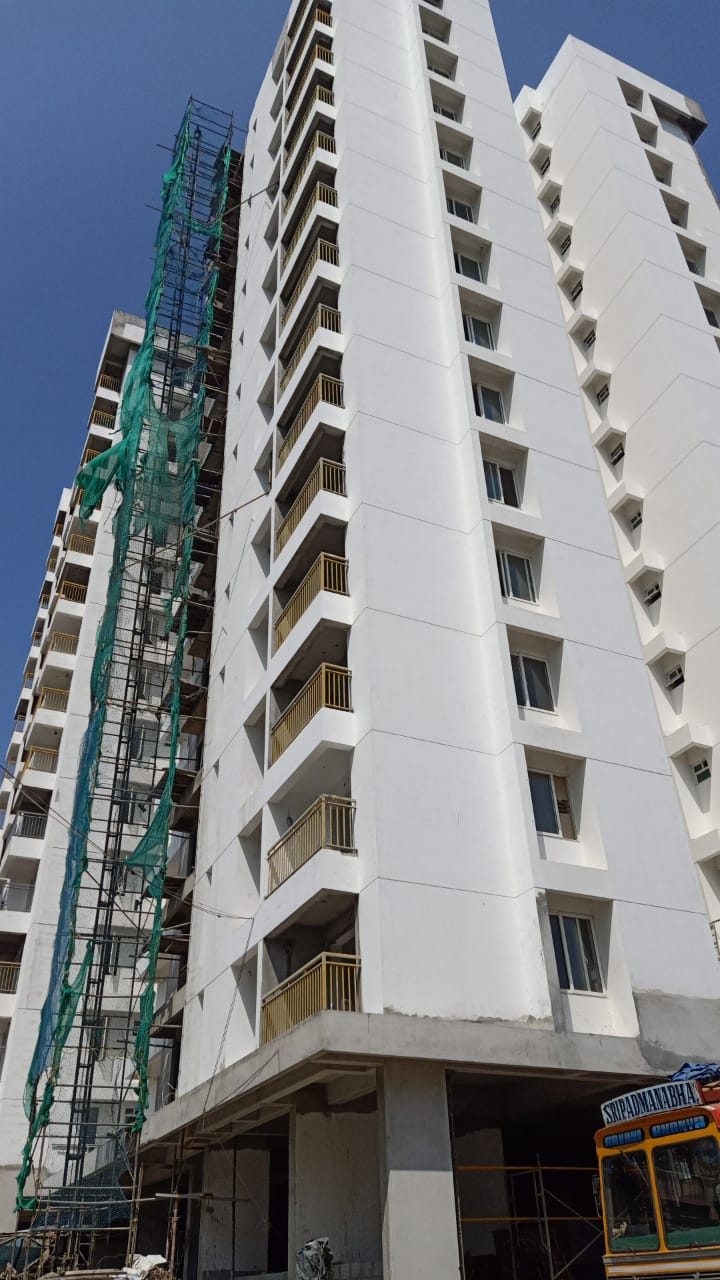

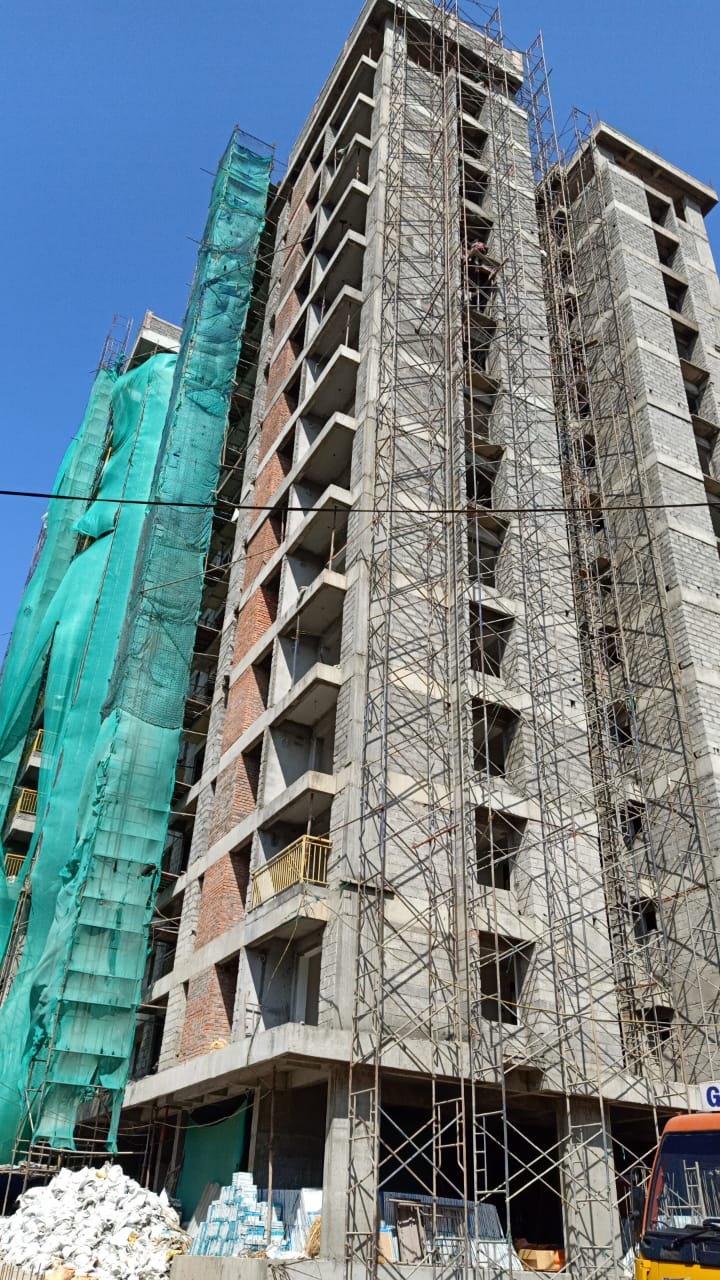

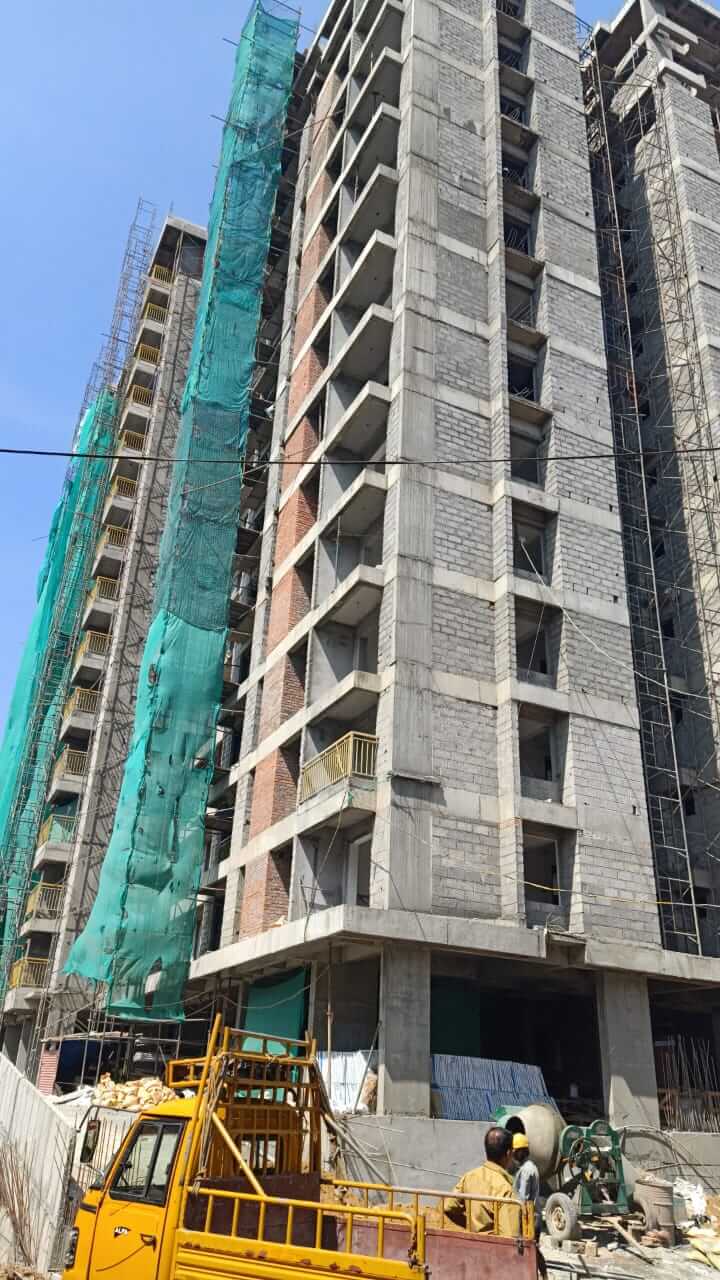

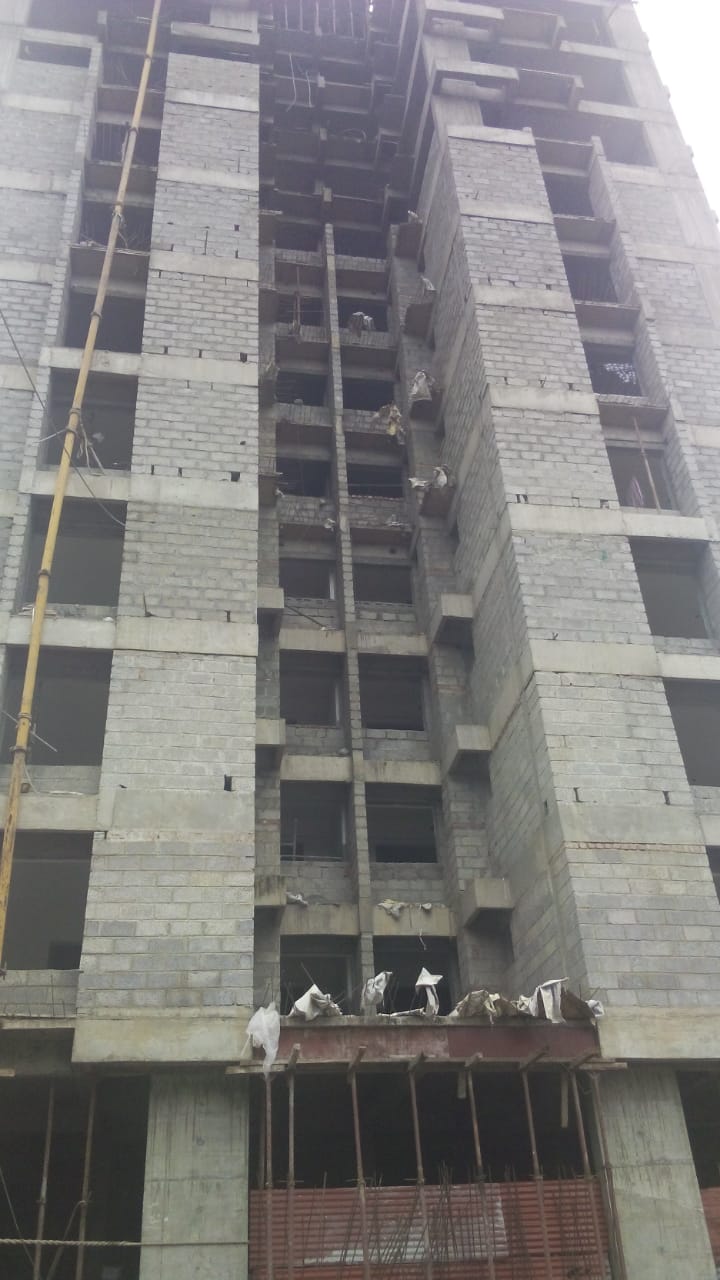

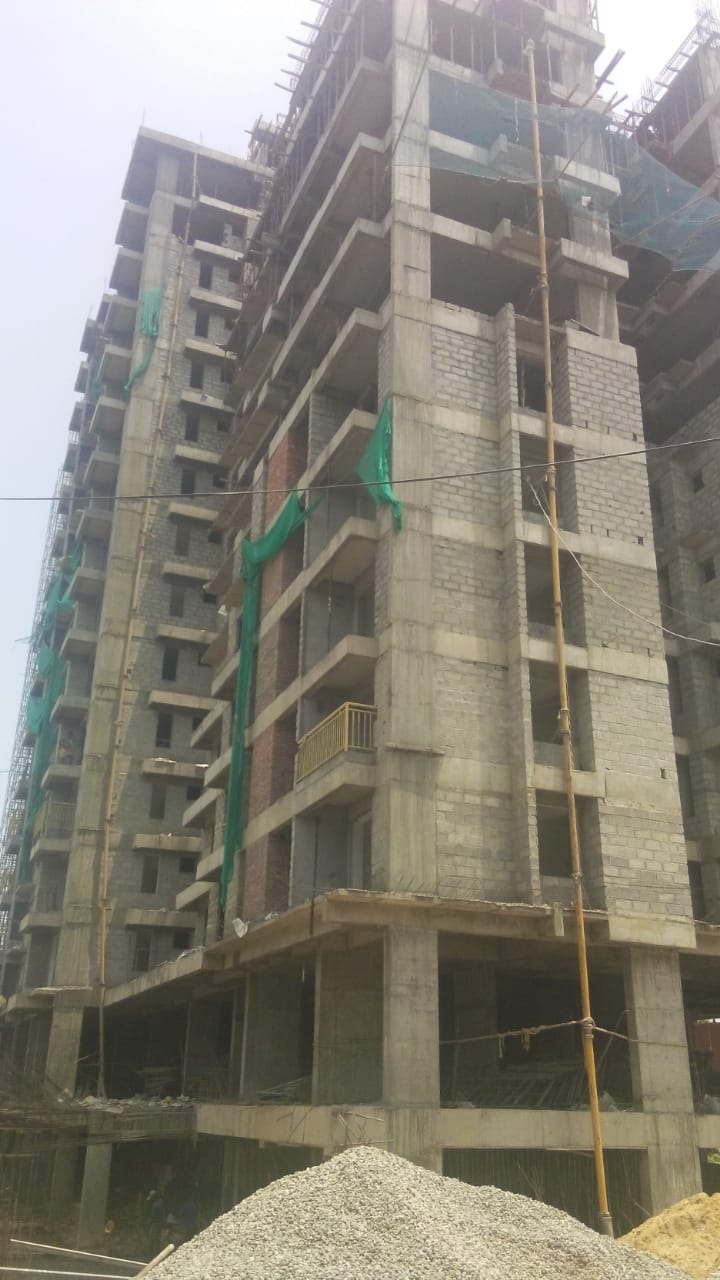

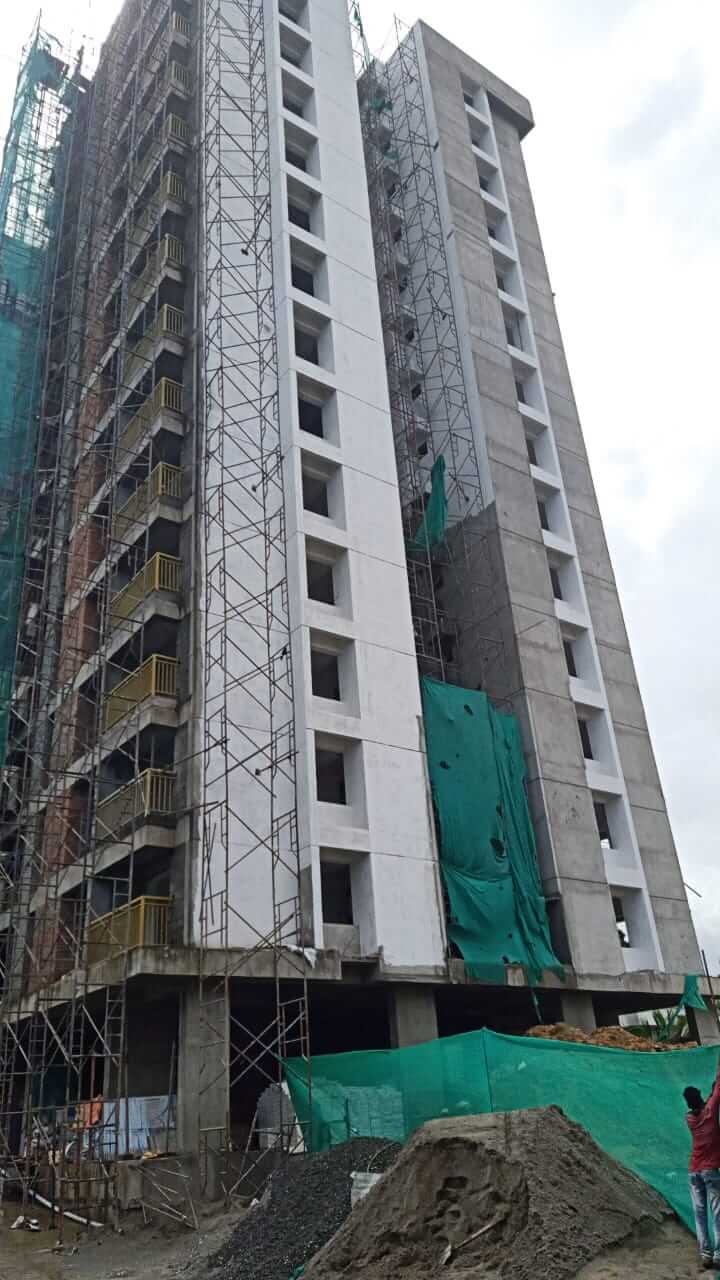

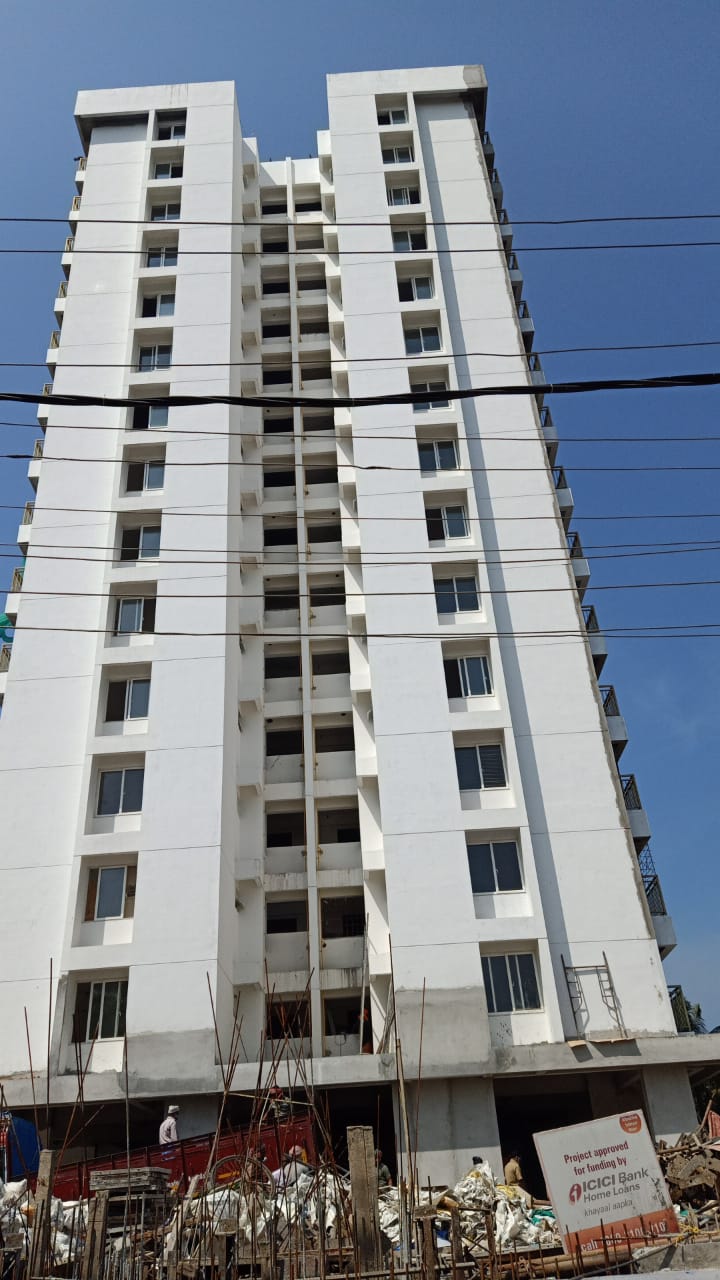

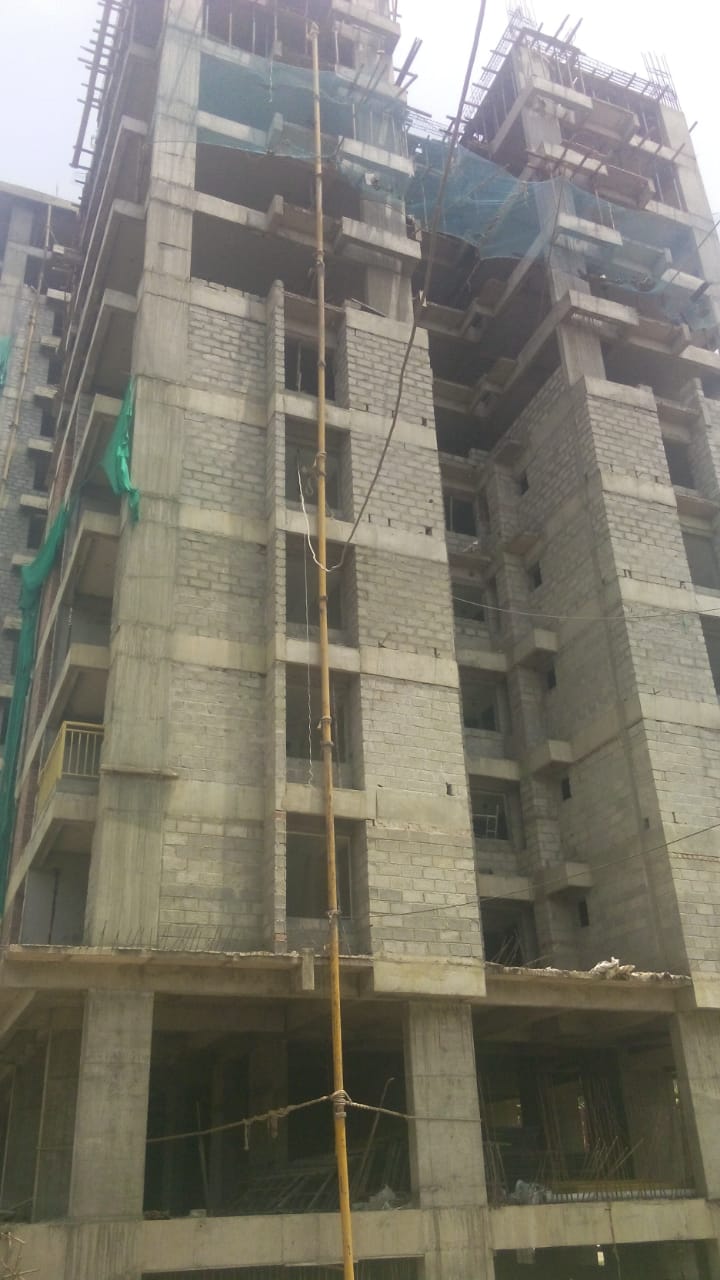

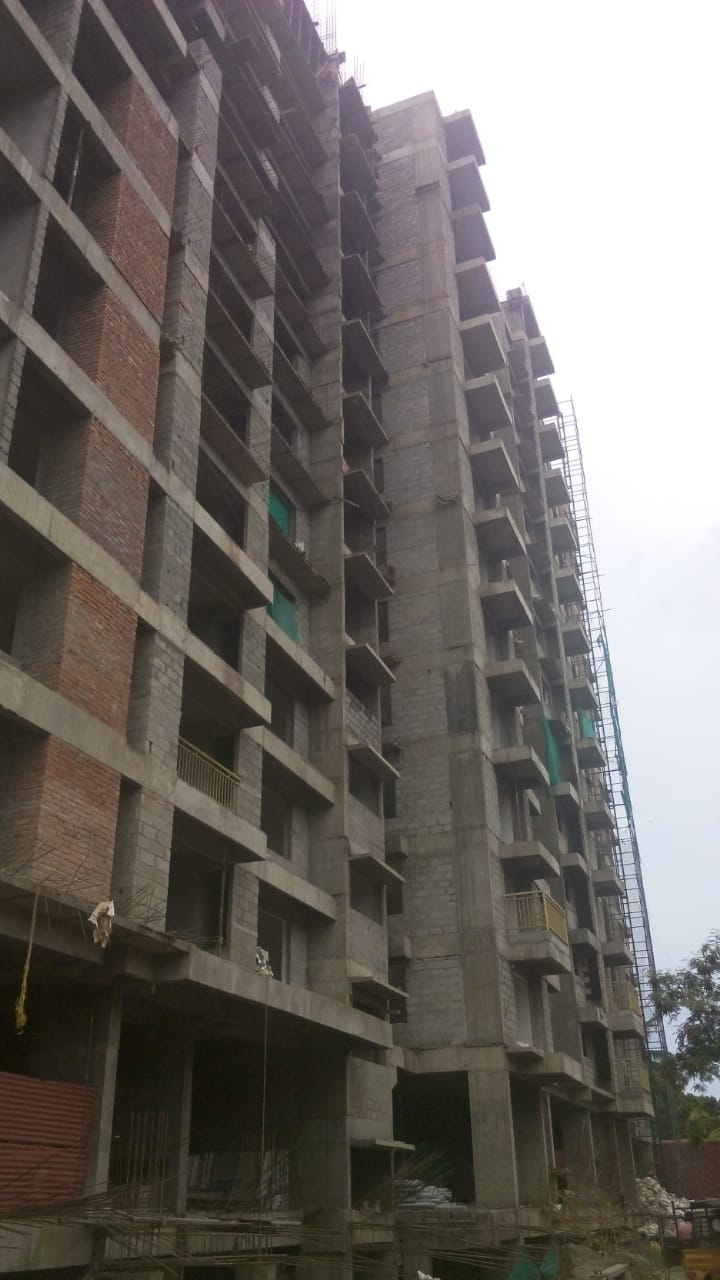

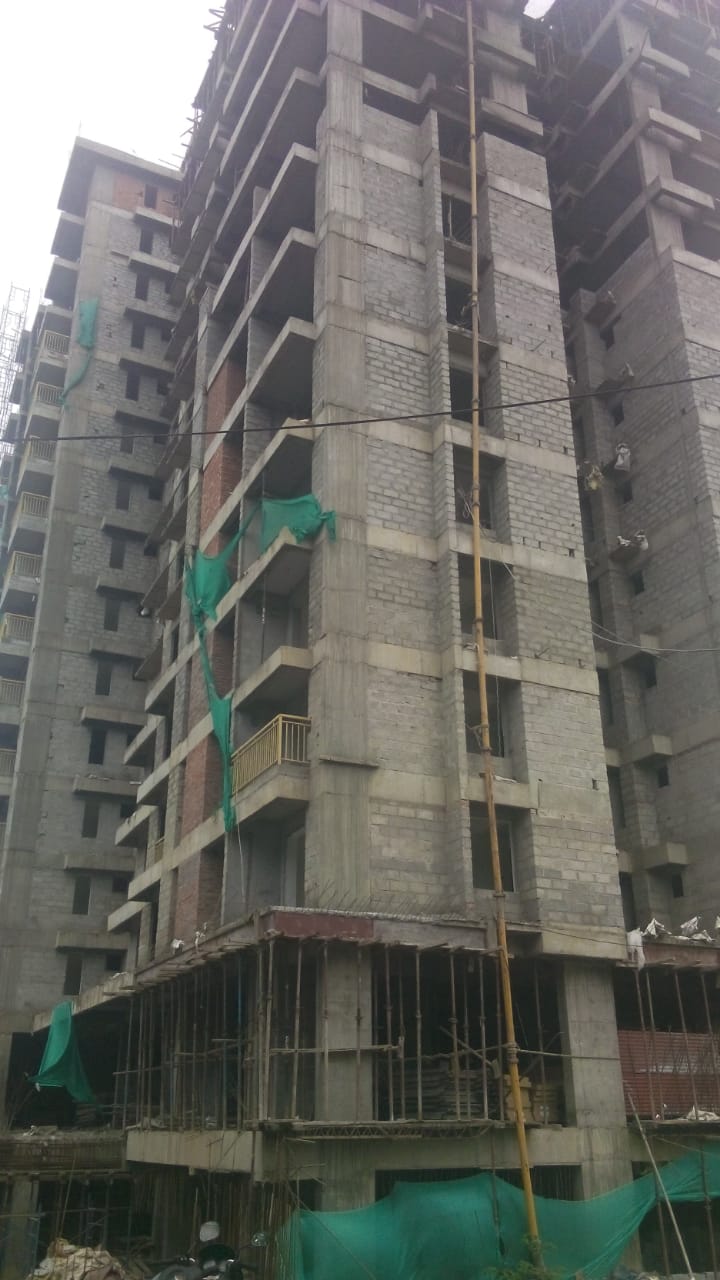

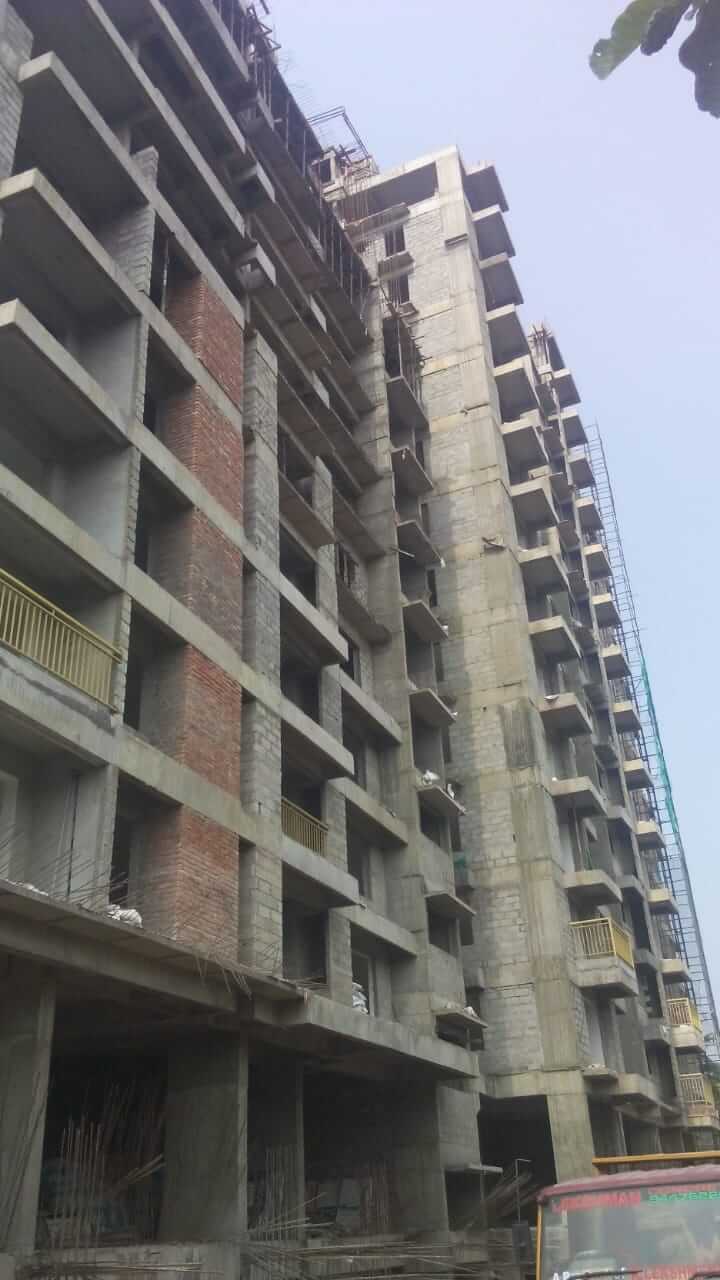

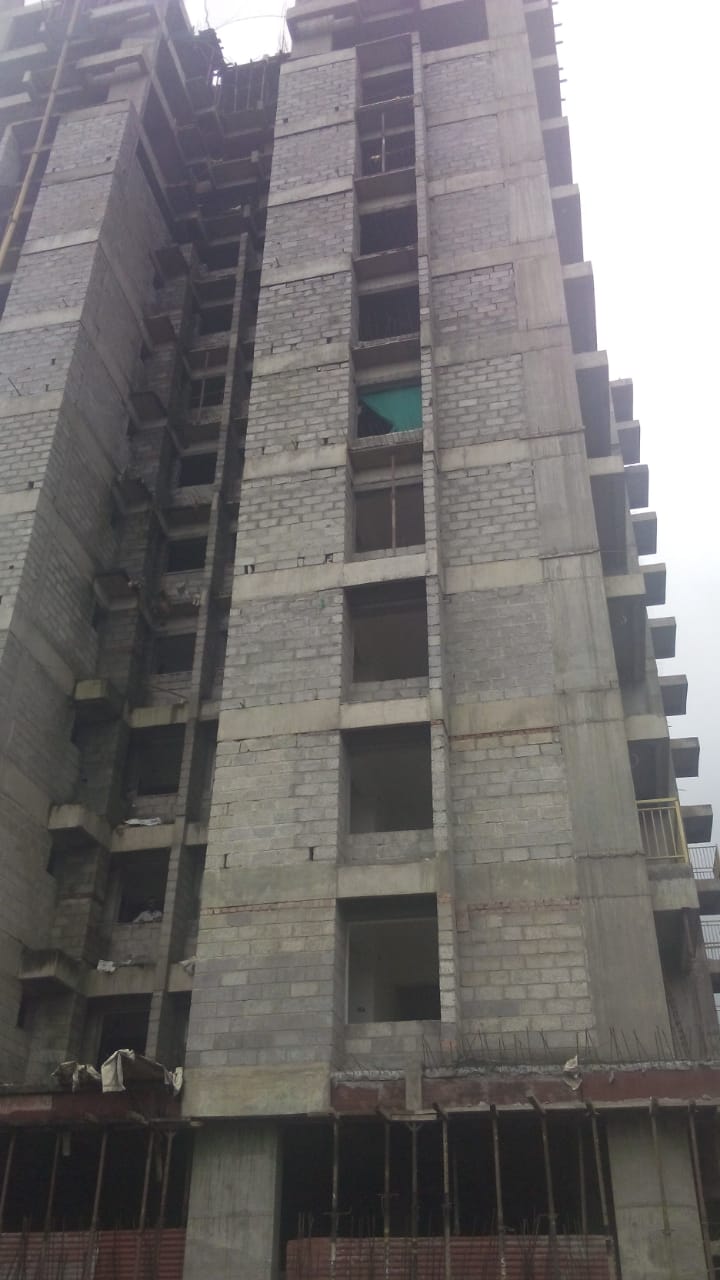

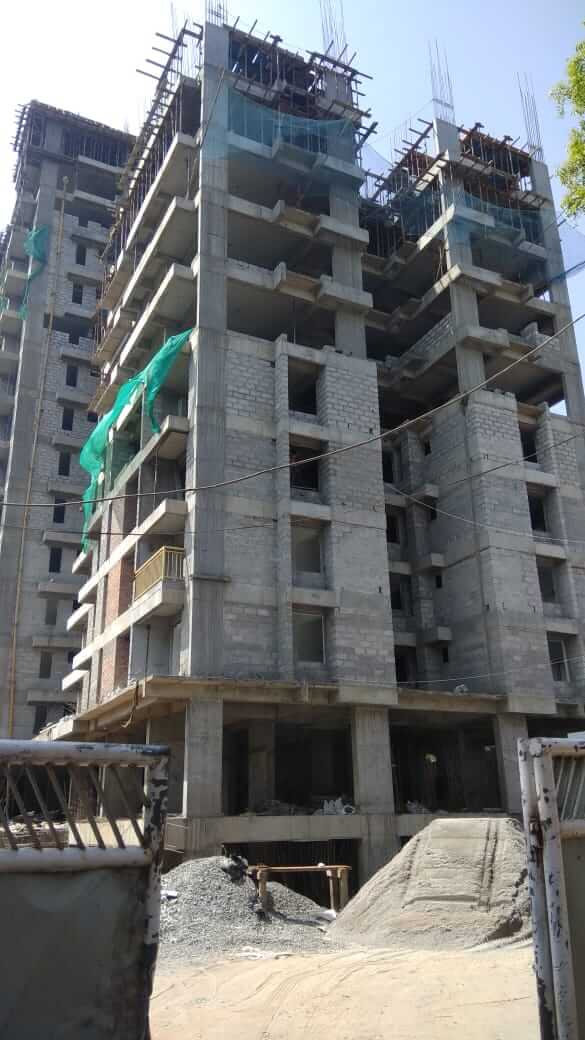

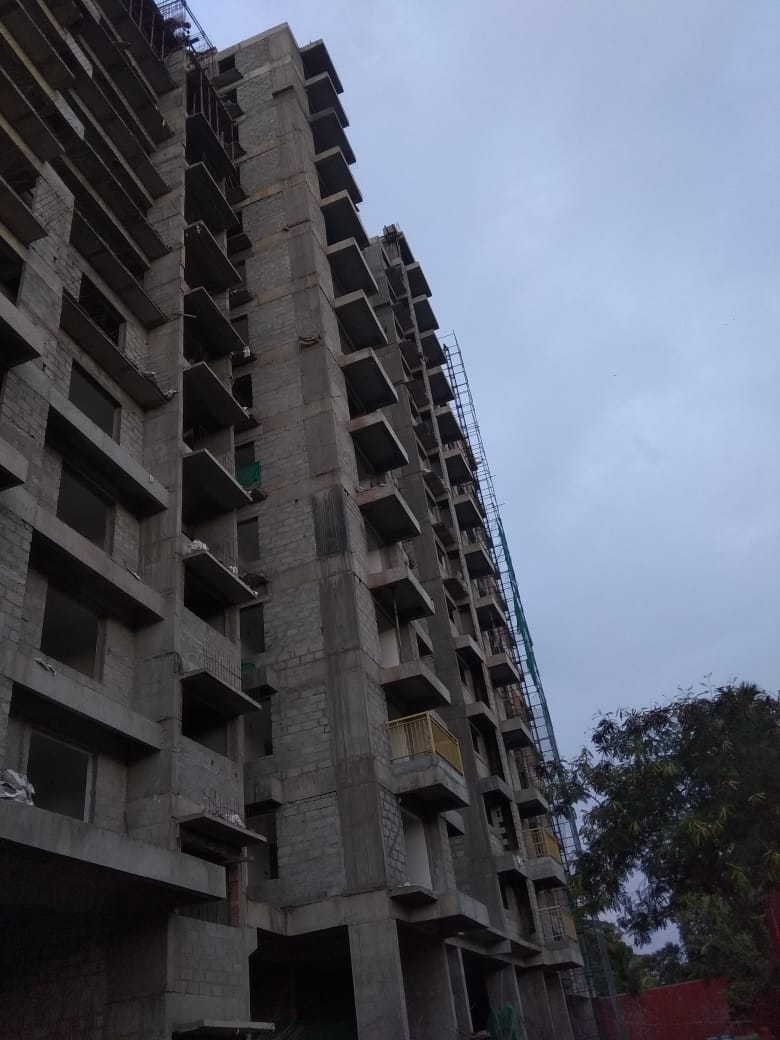

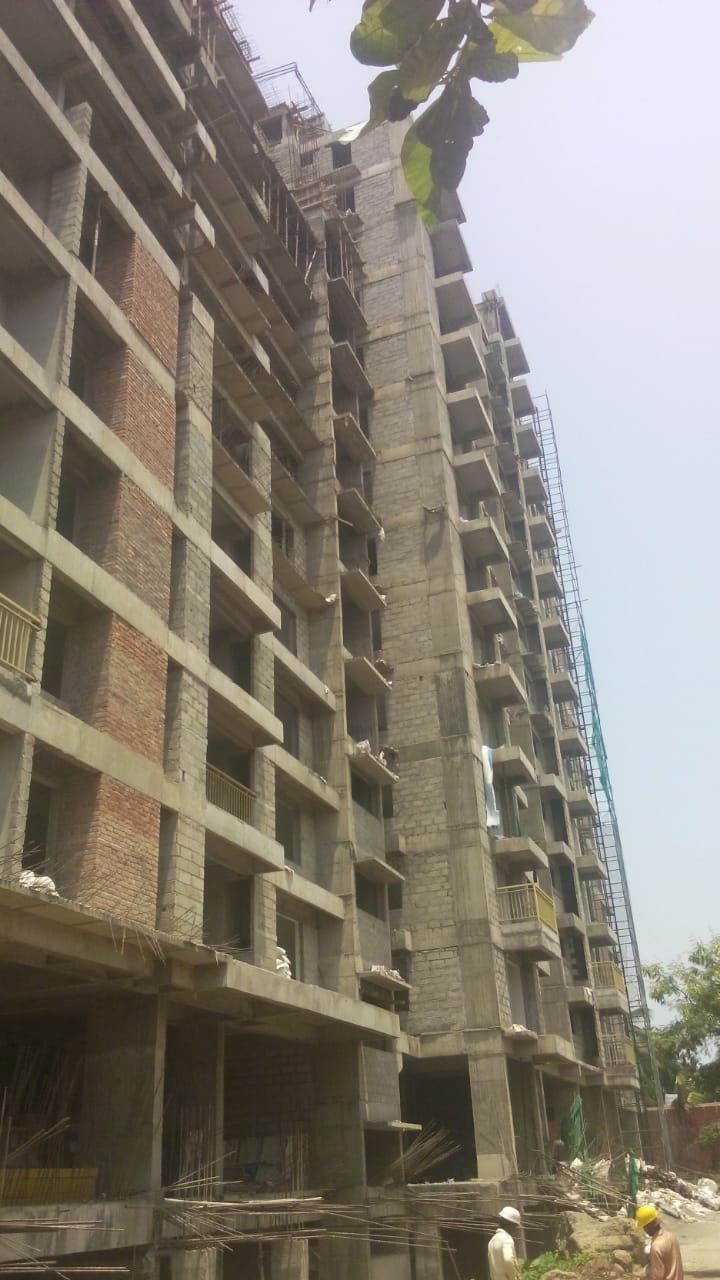

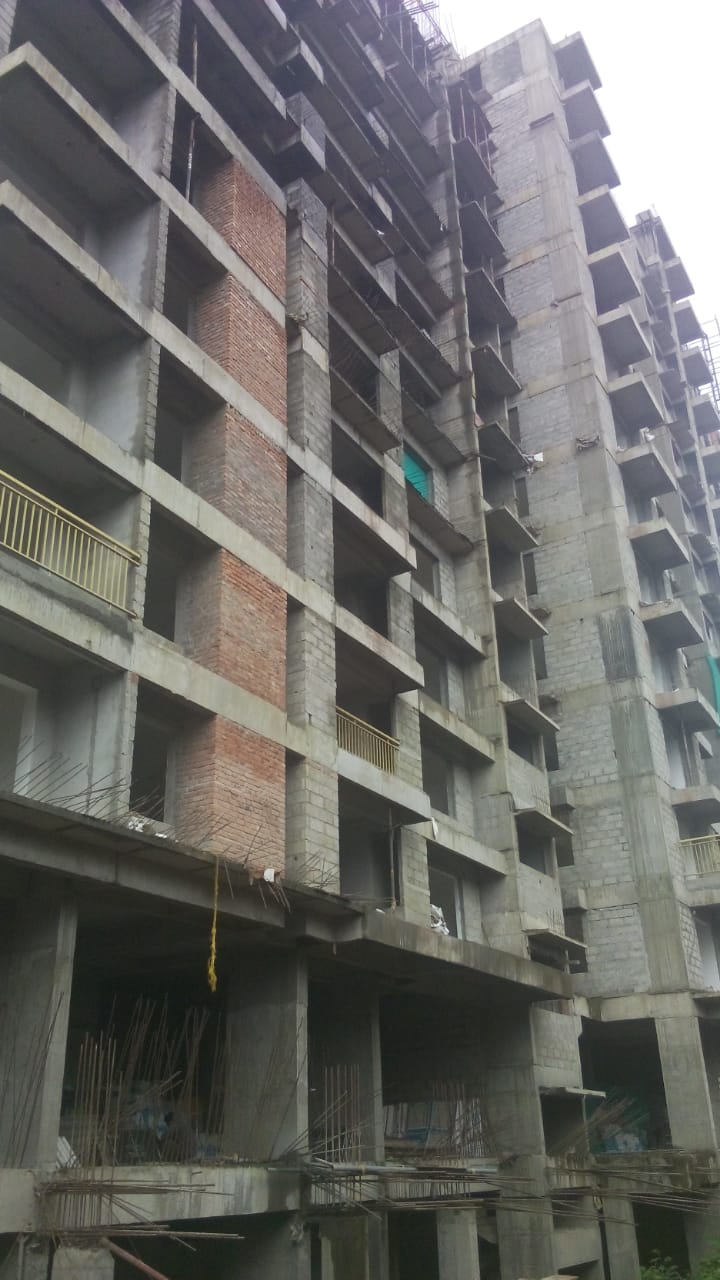

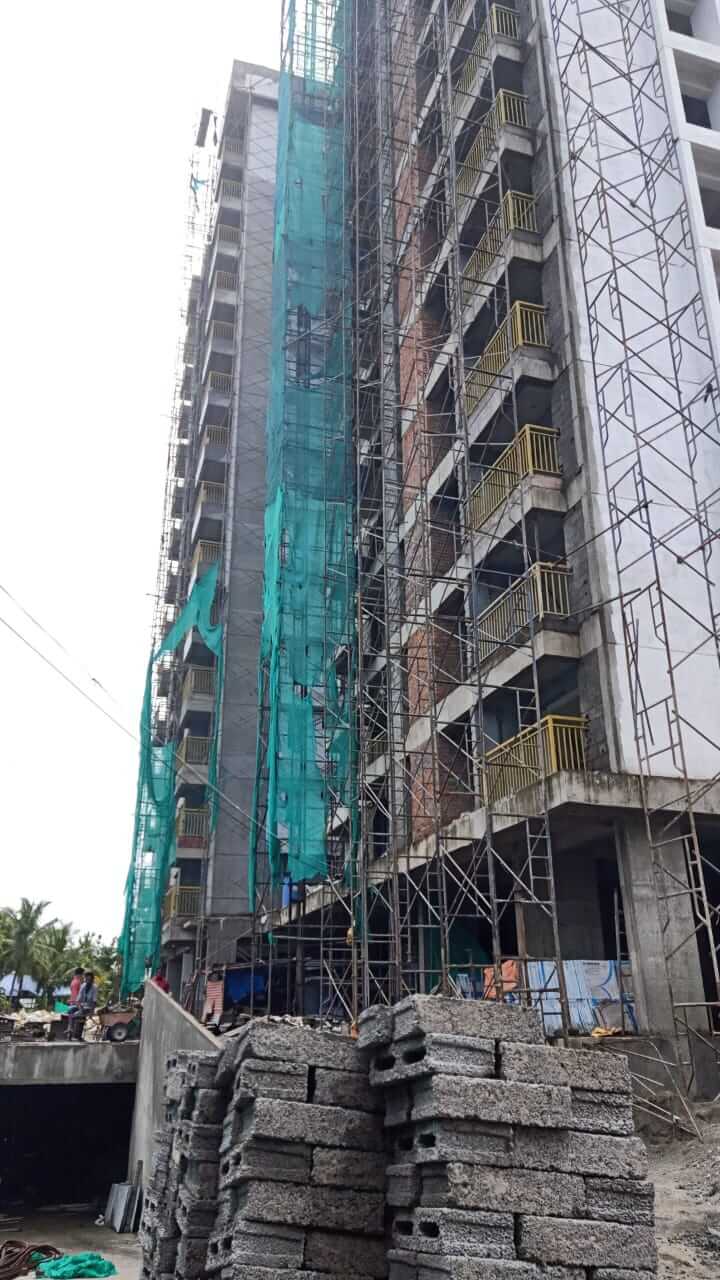

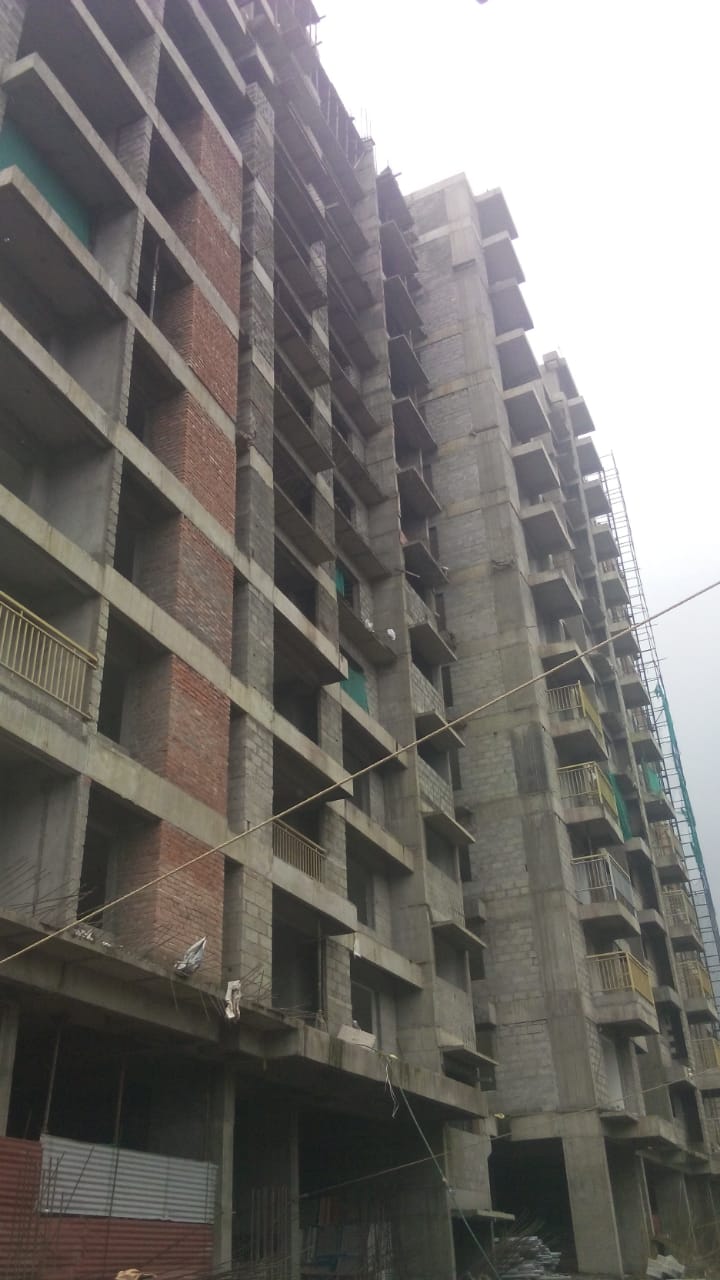

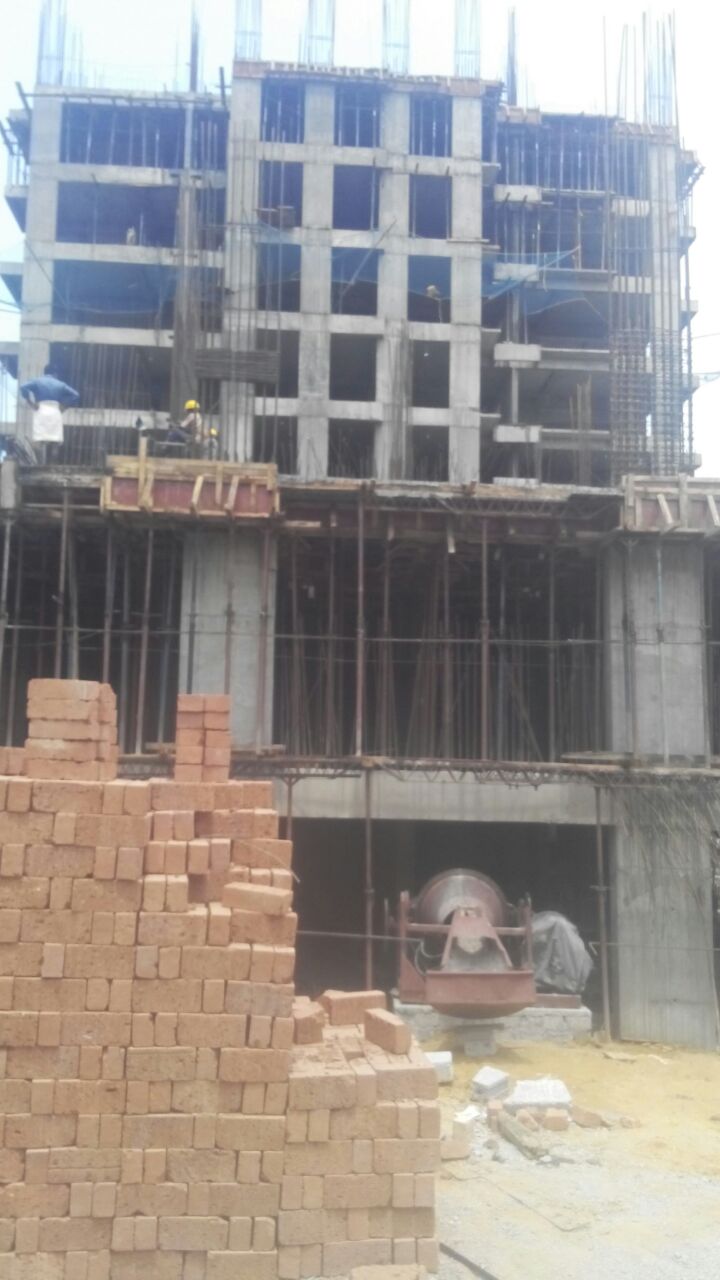

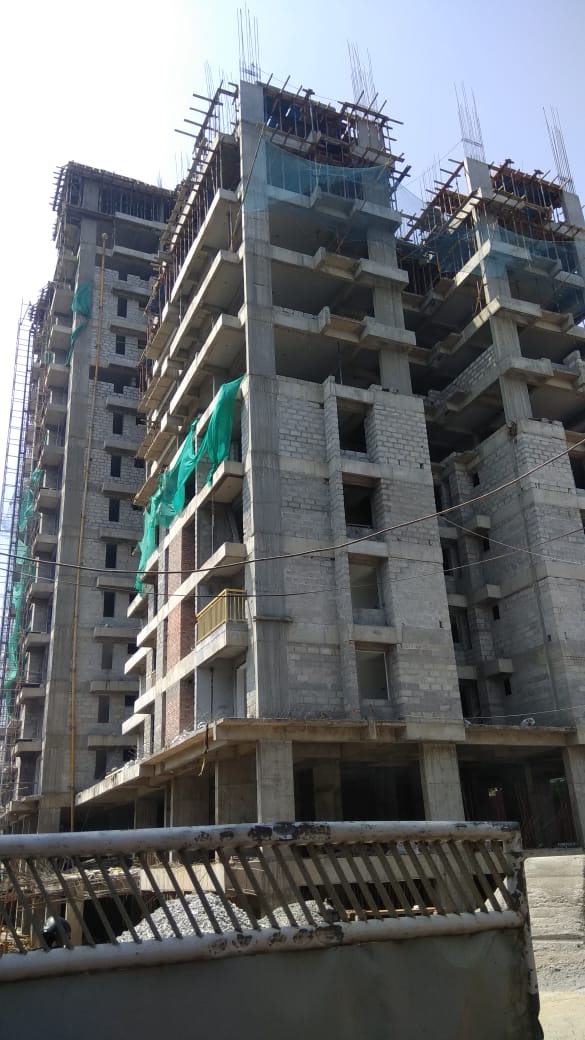

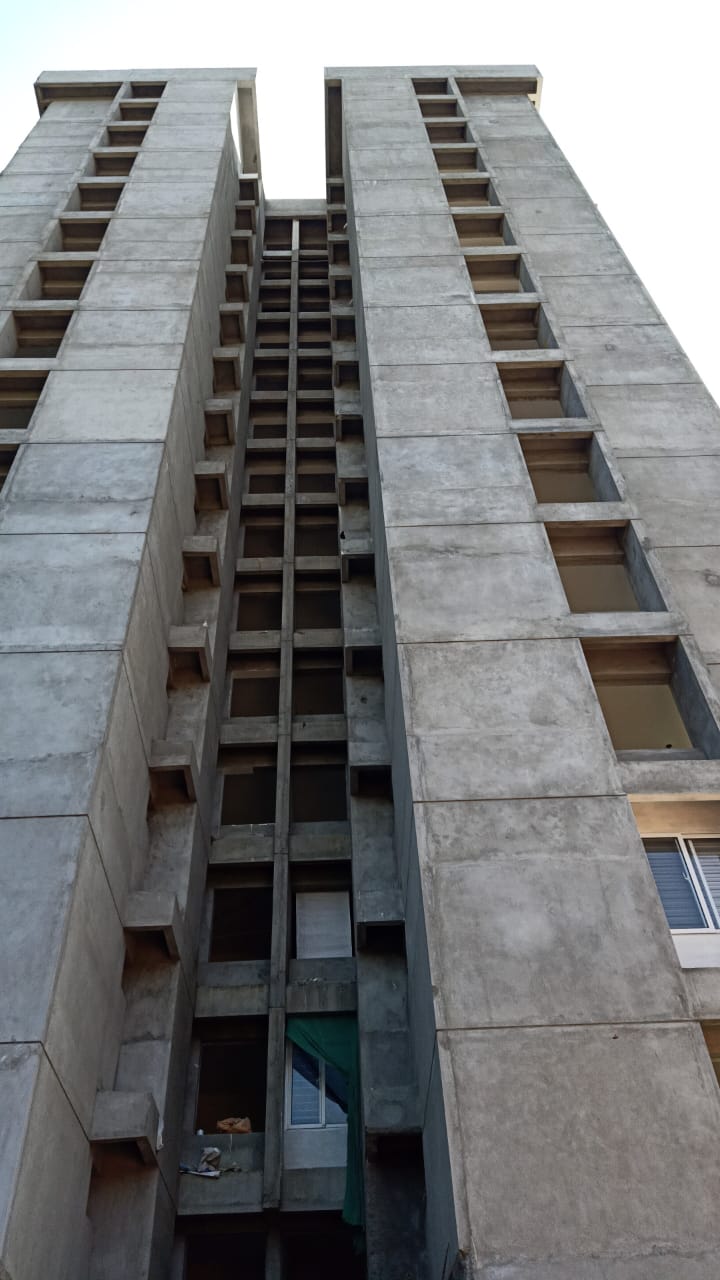

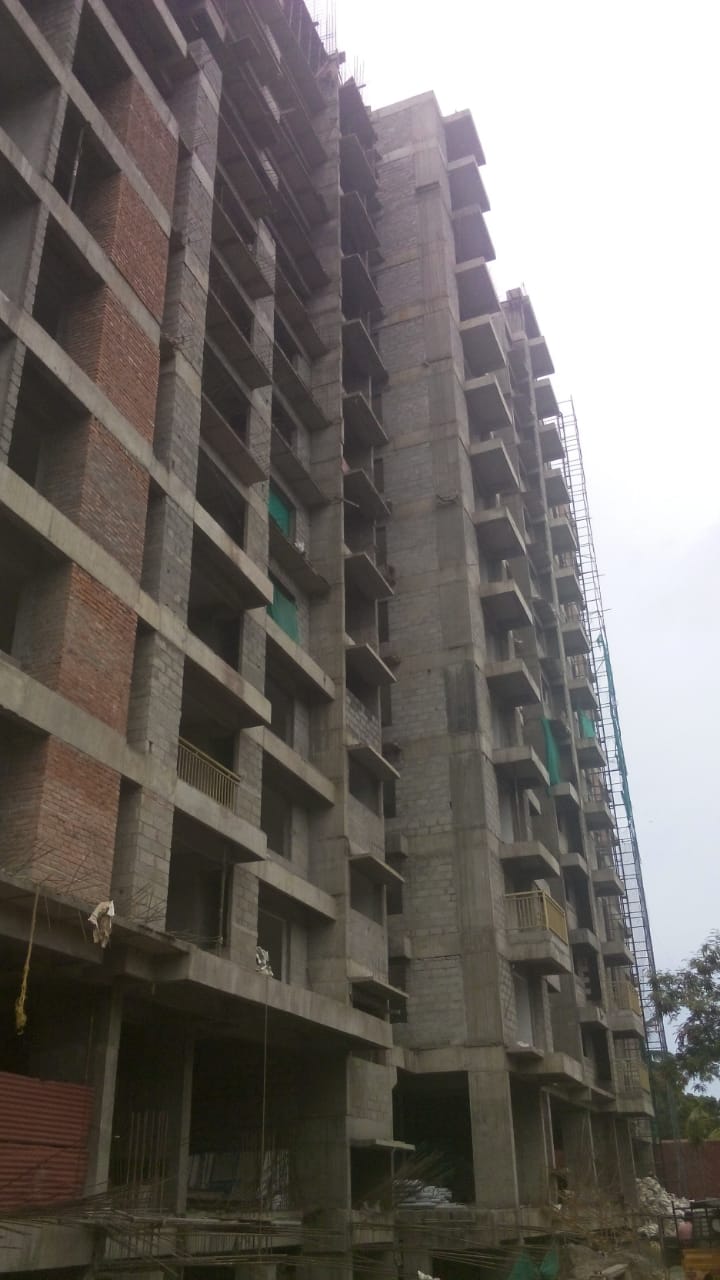

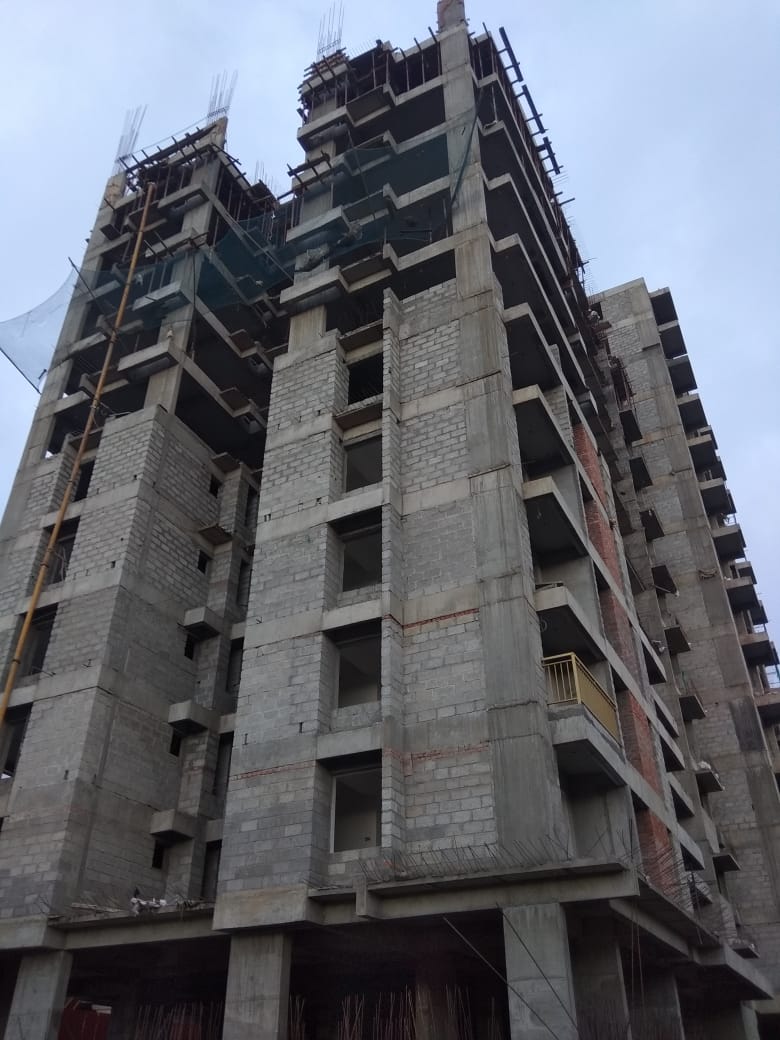

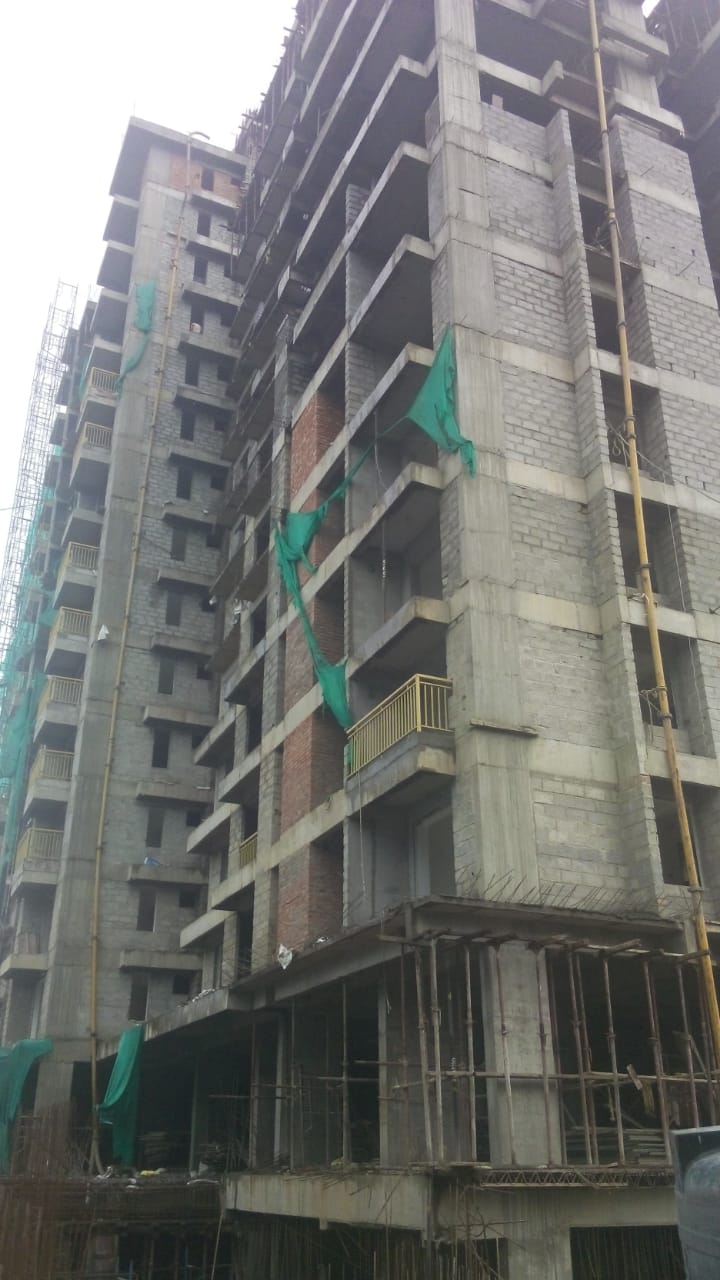

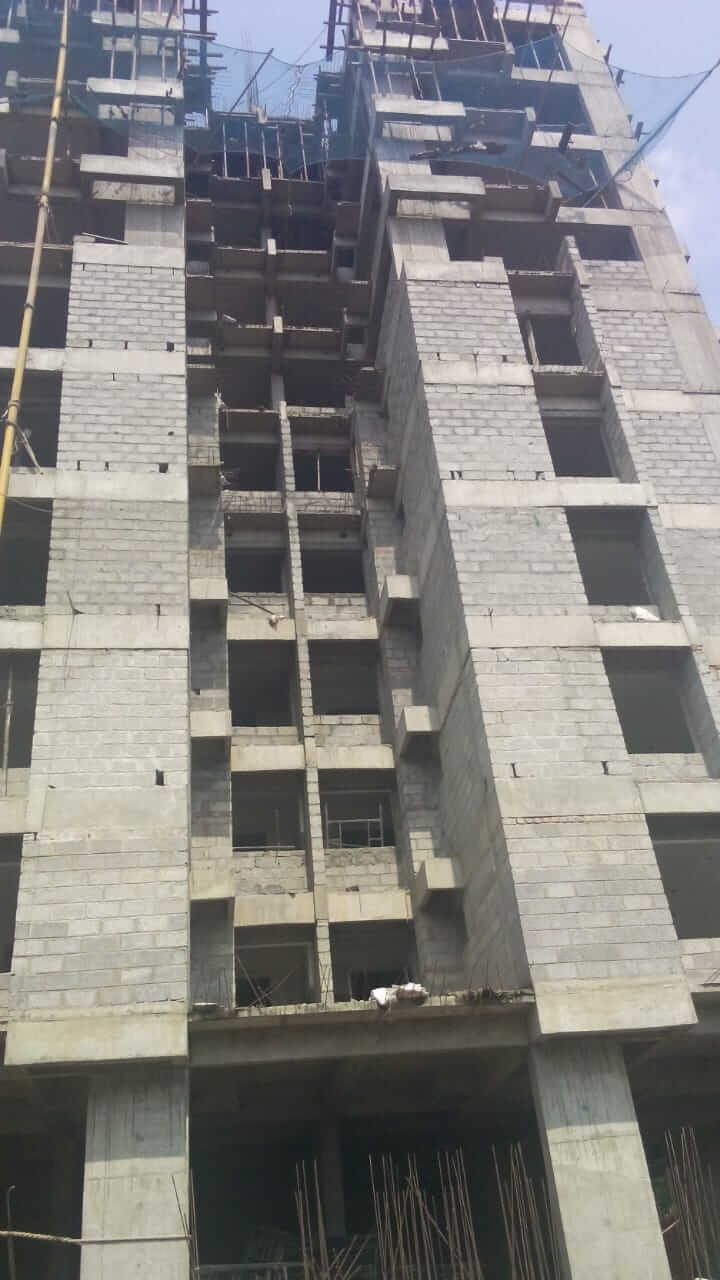

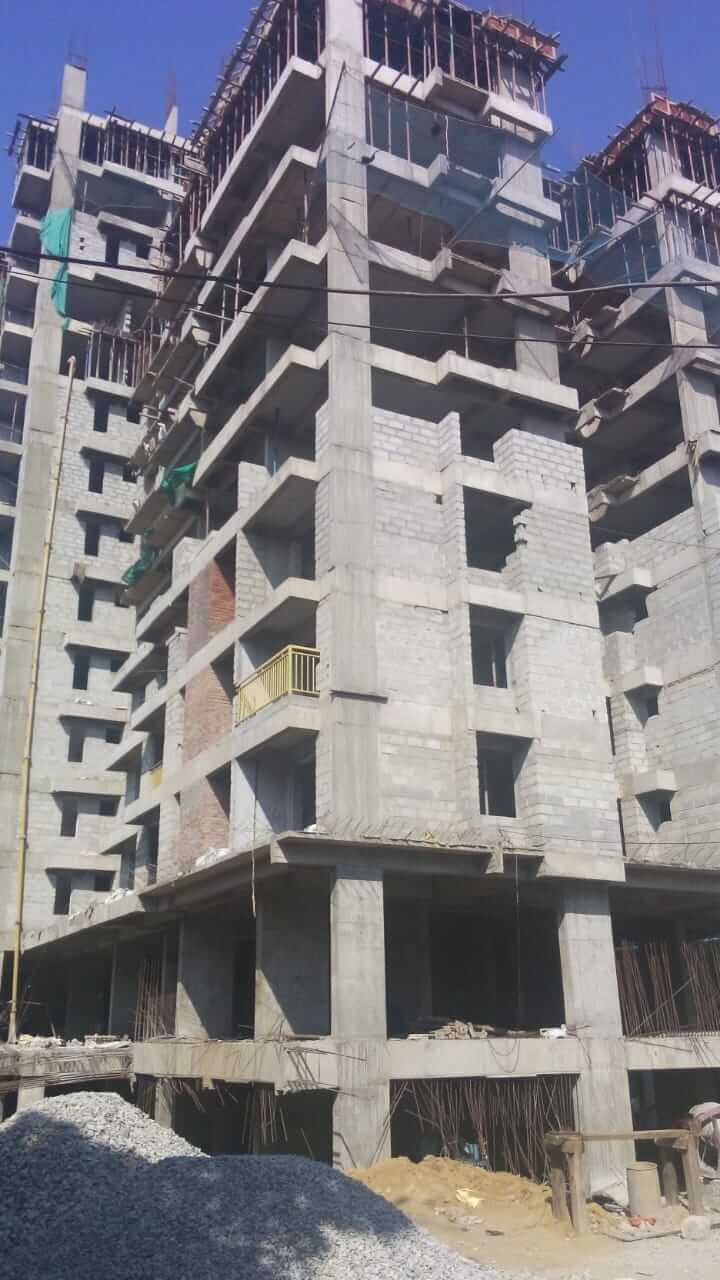

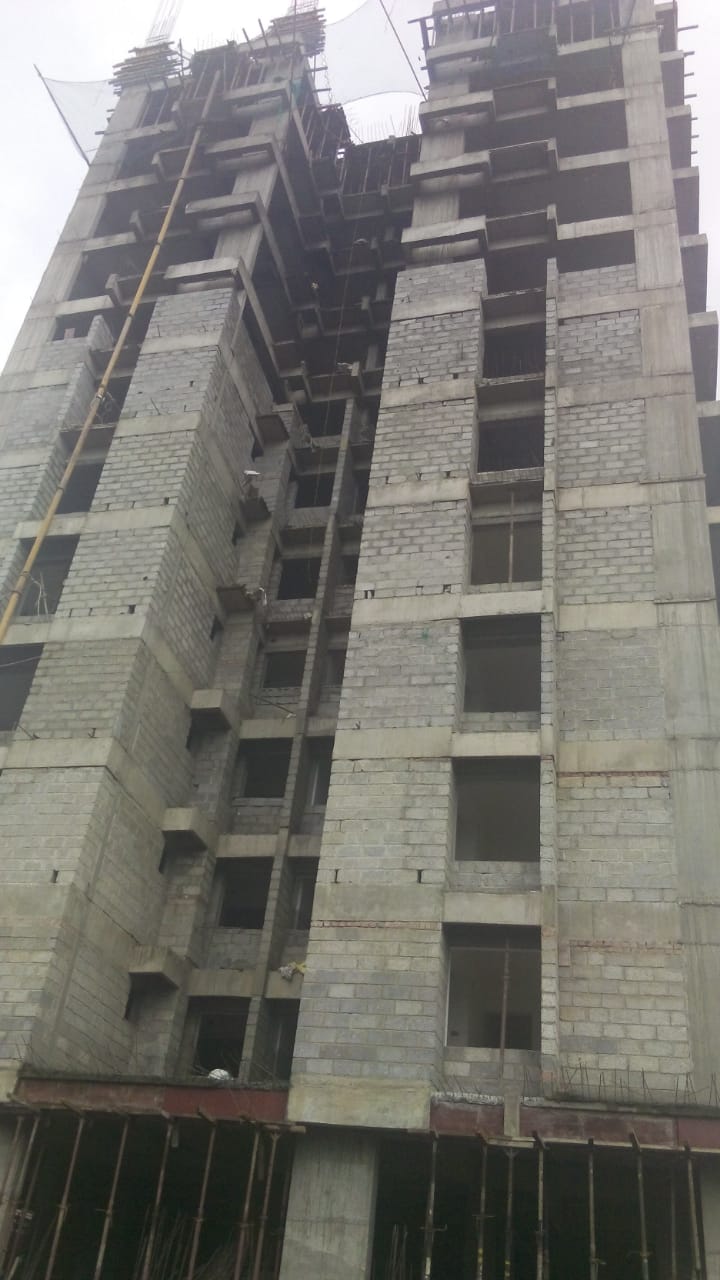

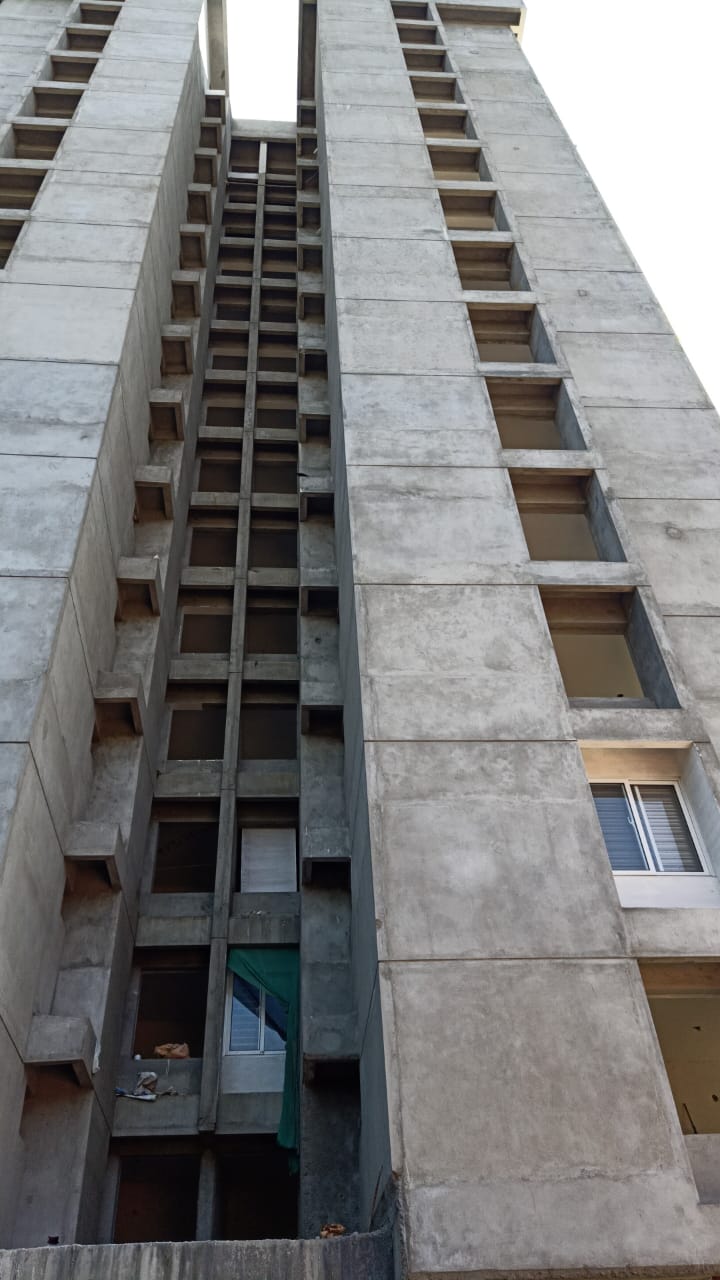

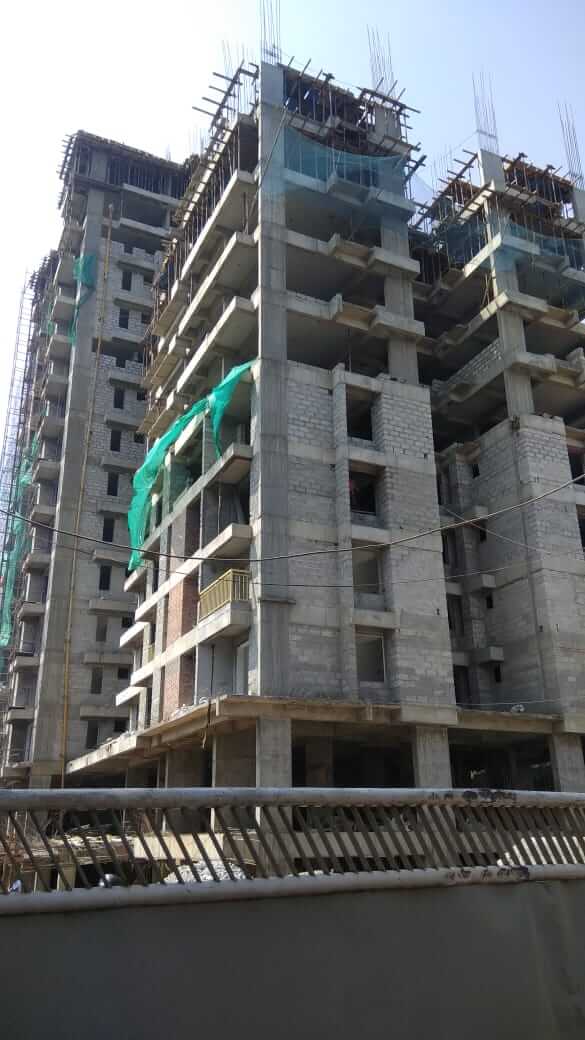

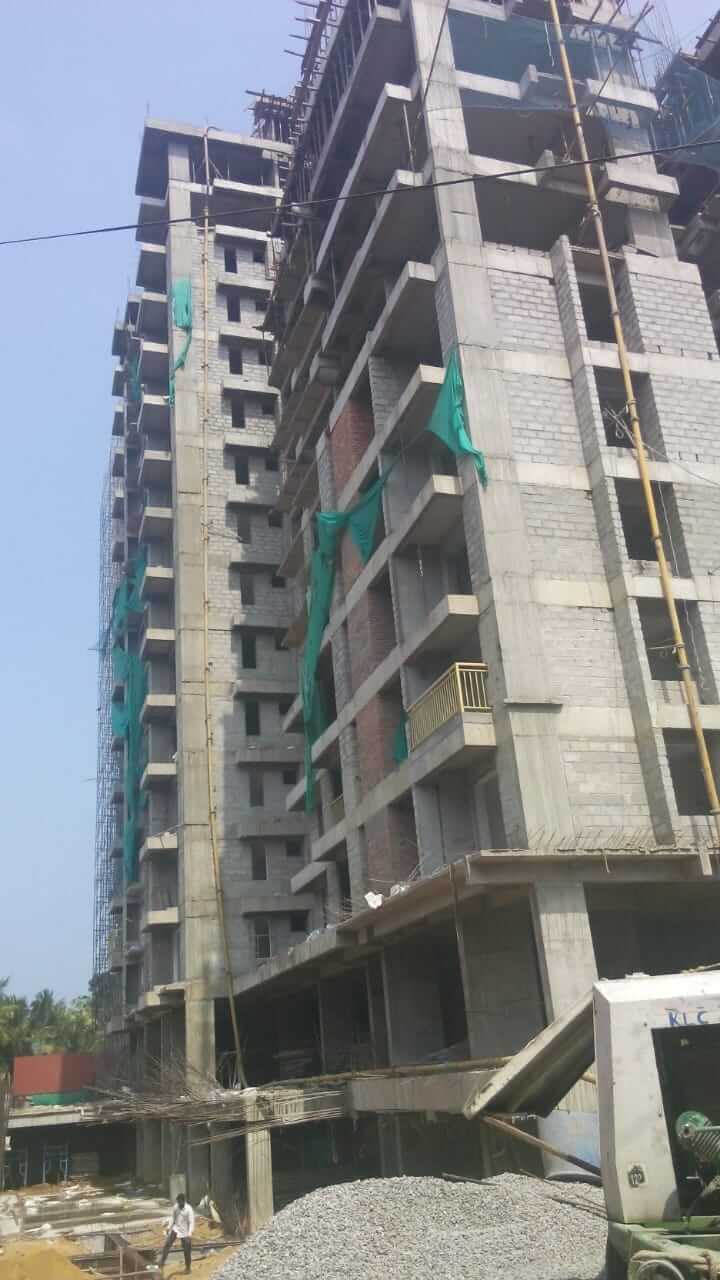

Artech VGP Sky Village - Progress
Work status as on 09-04-2021, we have completed the following.
- Earth work & Back filling – 100% completed
- RCC for structure – BF-16th floor -100% completed.
- Ceiling Plastering work – BF to16th floor -100% completed.
- Block work – ,BF-16th floor 100% completed
- Door frame fixing -1st -15 th floor,terrace floor-100% completed
- Electrical chasing work – 1st floor -16th floor (100% completed).
- Plumbing work -1st -16th floor -80% completed
- Wall plastering work – BF-16th floor (100% completed)
- Dadoing of Toilets:1st -12th floor-100% completed,13th-14th floor :-50% completed.
- Dadoing of kitchen walls:-
- Application of putty walls & ceiling :1-16th floor (100%completed)
- Wire pulling : 1st-16th floor -100% completed.
- Water proofing and pressure Grouting work: 1st -14th floor:- 100% completed,15th floor-50% completed,terrace floor-100% completed.
- Flooring and skirting:1st-13th floor:- 100% completed
- Aluminium Windows and Ventilators – 1st,3rd-14th floor-50% completed,2nd floor-100% completed.
- Grills &Handrails :1st -15th floor-100% completed.
- Fixing of Doors:1st -14th floor -100% completed
- Grills:-1st -15th floor-100% completed.
As per the current work status from our site, we are targeted to complete the following works by the end of APRIL 2021.
- Plumbing work-:-100% to be completed.
- Dadoing of Toilets:-upto 15th -90% to be completed
- Waterproofing and pressure Grouting work:- 15th-16th 100% to be completed.
- Flooring and skirting:-upto 15th floor -85% to be completed
- Aluminum Windows and Ventilators:-BF-15th floor:-90% to be completed.
- Grills &Handrails:-100% to be completed.
- Fixing of Doors:-100% to be completed
- Grills &Handrails:-100% to be completed.

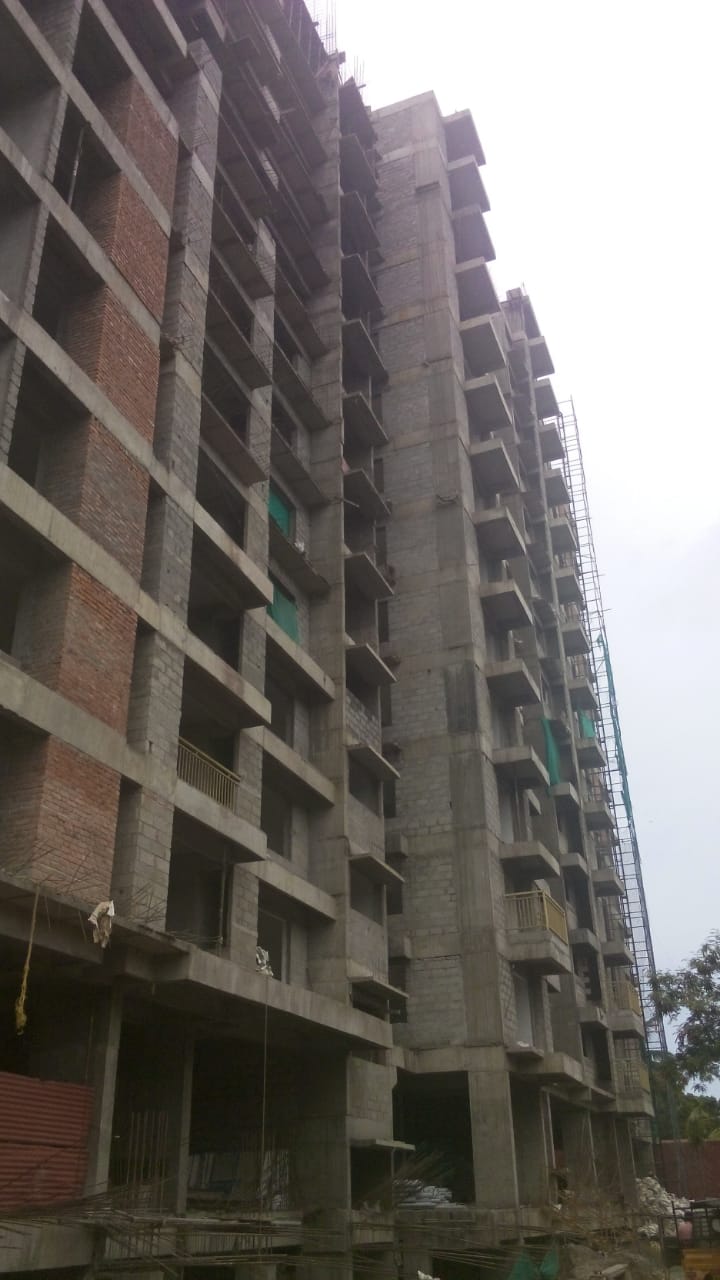

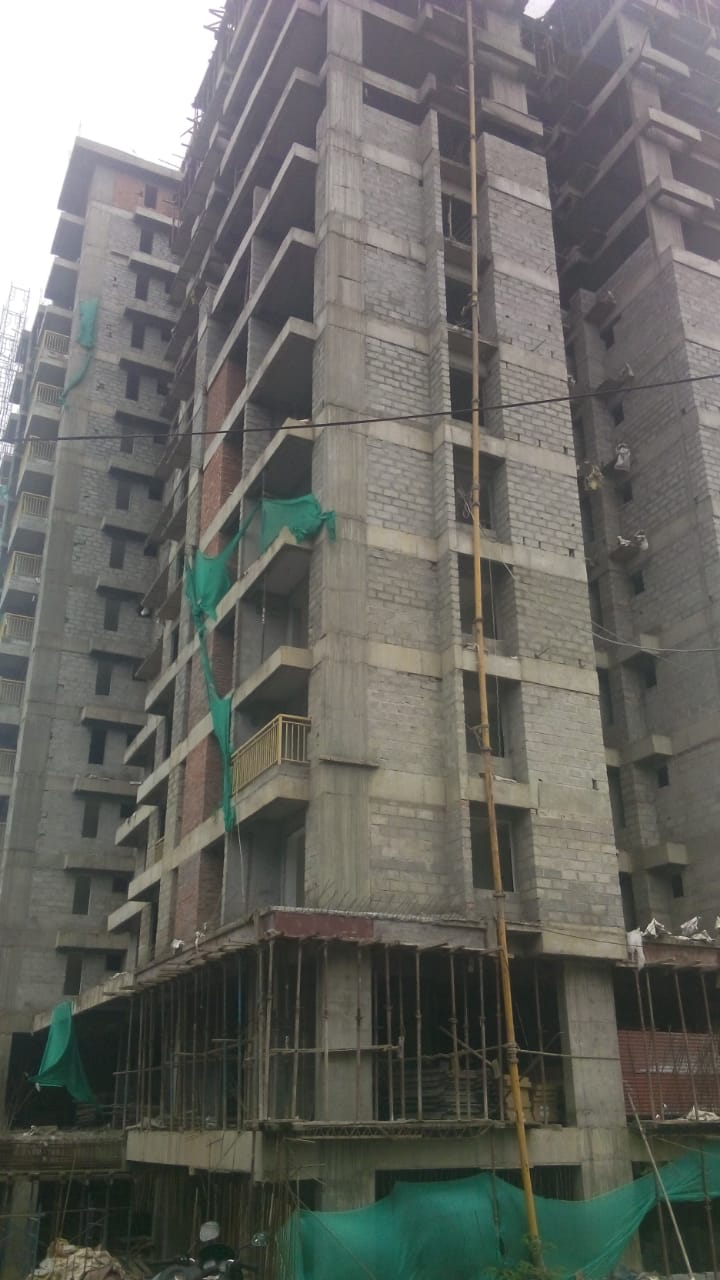

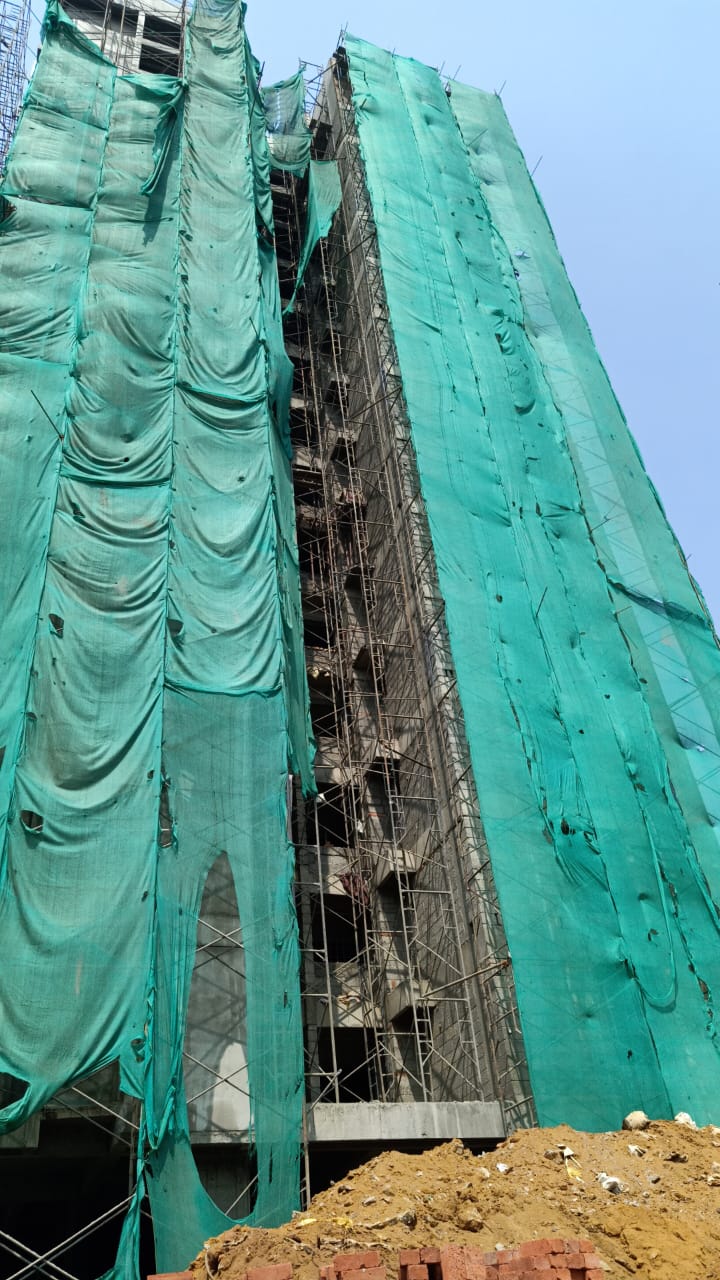

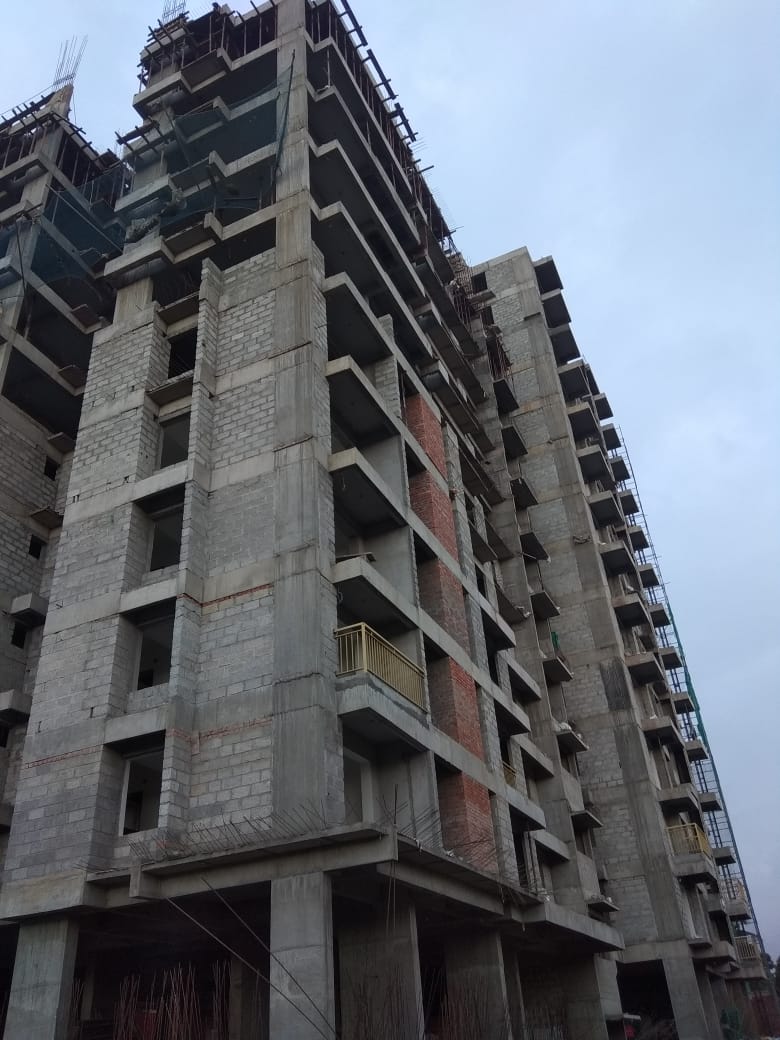

Work status as on 11-03–2021, we have completed the following.
- Earth work & Back filling – 100% completed
- RCC for structure – BF-16th floor -100% completed.
- Ceiling Plastering work – BF to16th floor -100% completed.
- Block work – ,BF-16th floor 100% completed
- Door frame fixing -1st -15 th floor,terrace floor-100% completed
- Electrical chasing work – 1st floor -16th floor (100% completed).
- Plumbing work -1st -16th floor -80% completed
- Wall plastering work – BF-16th floor (100% completed)
- Dadoing of Toilets:1st -12th floor-100% completed,13th-14th floor :-50% completed.
- Dadoing of kitchen walls:-
- Application of putty walls & ceiling :1-16th floor (100%completed)
- Wire pulling : 1st-16th floor -100% completed,
- Water proofing and pressure Grouting work: 1st -14th floor:- 100% completed,15th floor-50% completed
- Flooring and skirting :1st-13th floor:- 100% completed
- Aluminium Windows and Ventilators – 1st -13th floor-50% completed
- Grills &Handrails :1st -15th floor-100% completed.
- Fixing of Doors:1st -9th floor -100% completed
- Grills :-1st -15th floor-100% completed.
- Painting :(1 st coat putty ) -1st -2nd floor (100% completed), 3rd,4th,5th floor :-50% completed.
- DB Dressing & Switch fixing :-1st -9 th floor (50%completed).
- Fire fighting -2 nd floor- 75% completed,BF and GF -work in progress
- H .T WORK:- cable pulling completed.-50% completed.
- Lift Work – 2 Nos erection work on Progressing,2nd completed
- External Plastering Work : 1st – 16th floor -100% completed
- mockup flat -100% completed
As per the current work status from our site, we are targeted to complete the following works by the end of MARCH 2021.
- Plumbing work-:-100% to be completed.
- Dadoing of Toilets: 13th -14th -100% to be completed,15th floor-75% to be completed.
- Flooring and skirting:-14th-15th floor -90% to be completed
- Aluminum Windows and Ventilators:-BF-15th floor:-90% to be completed.
- Fixing of Doors:-10th-14th floor -90% to be completed
- Painting :(1 st coat putty ) BF-8th floor:-100% to be completed
- DB Dressing & Switch fixing:- up to 12th floor- 50% to be completed.
- Fire fighting -100% to be completed
- H.T work :-80% to be completed.
- Lift Work:- 100% to be completed.
As per the current work status from our site, we are targeted to complete the following works by the end of February 2021.
- Plumbing work-:-100% to be completed.
- Dadoing of Toilets: 13th -14th -100% to be completed,15th floor-75% to be completed.
- Flooring and skirting:-14th floor: -75% to be completed,15th floor -50% to be completed
- Aluminum Windows and Ventilators:-BF-15th floor:-75% to be completed.
- Fixing of Doors:-10th-14th floor -100% to be completed
- Painting :(1 st coat putty ) BF-8th floor :-100% to be completed
- DB Dressing & Switch fixing :- upto 12th floor- 50% to be completed.
- Fire fighting -80% to be completed
- H.T work :-75% to be completed.
- Lift Work:- 100% to be completed.

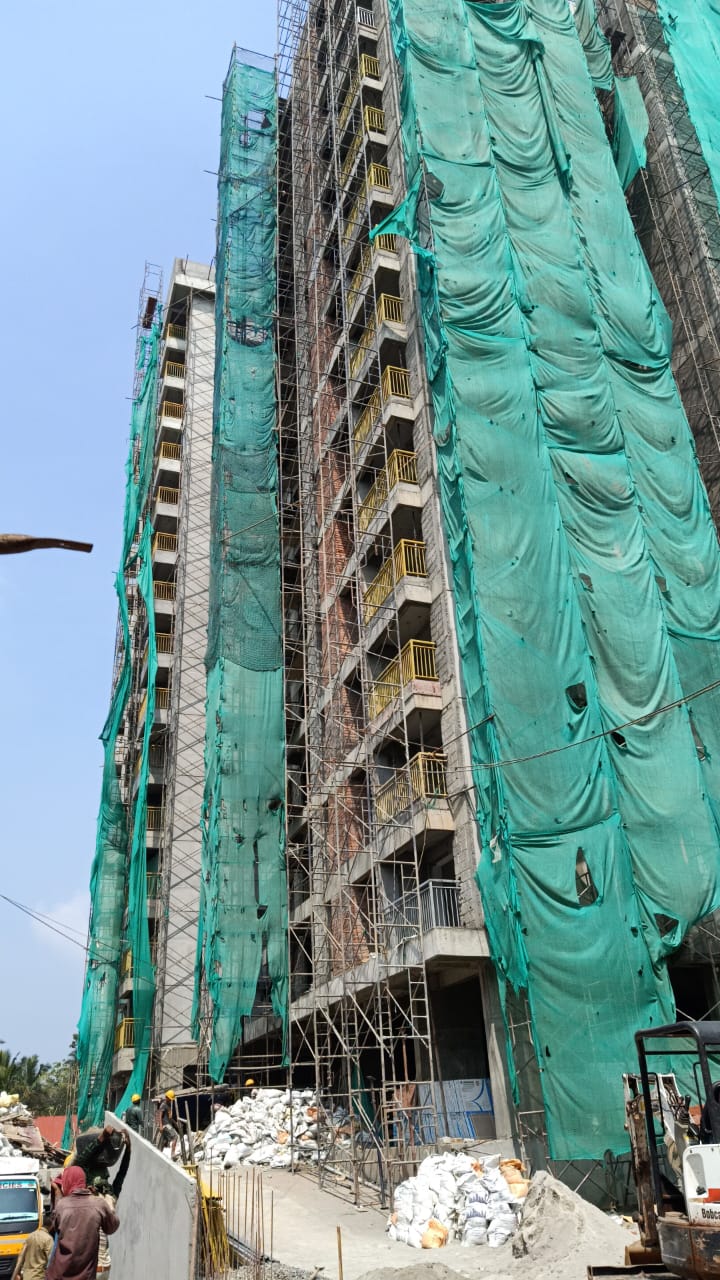

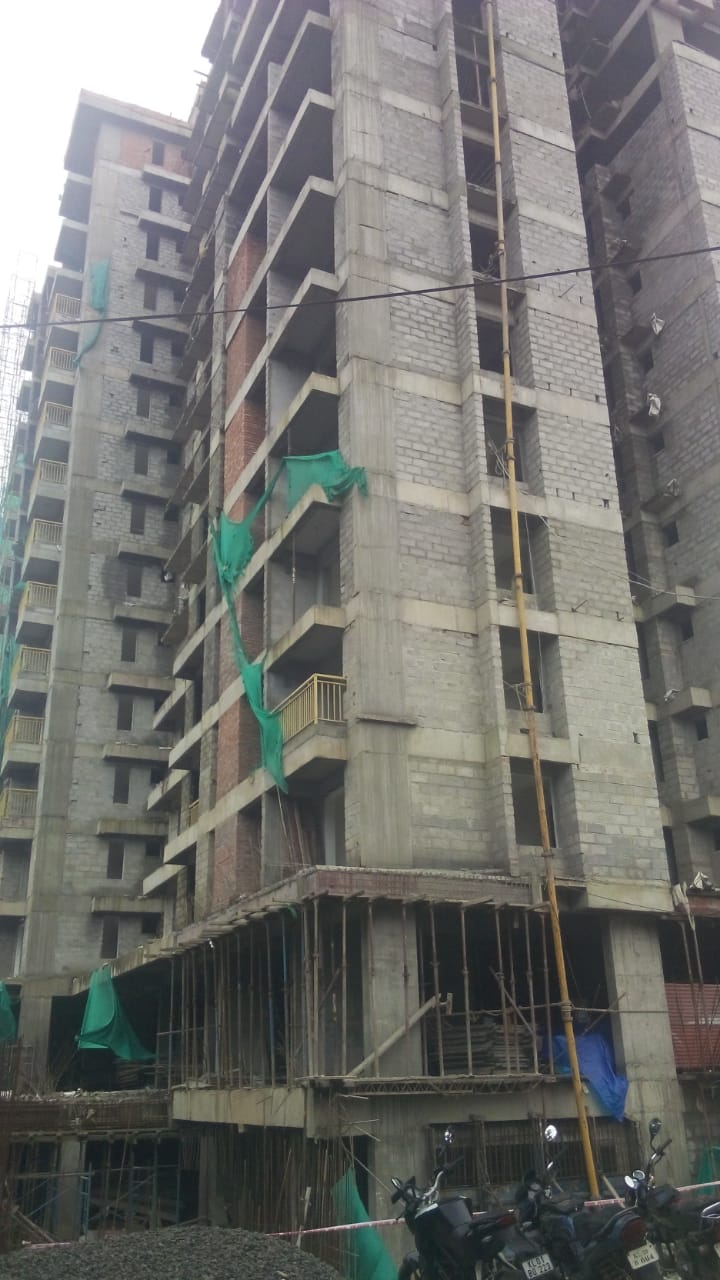

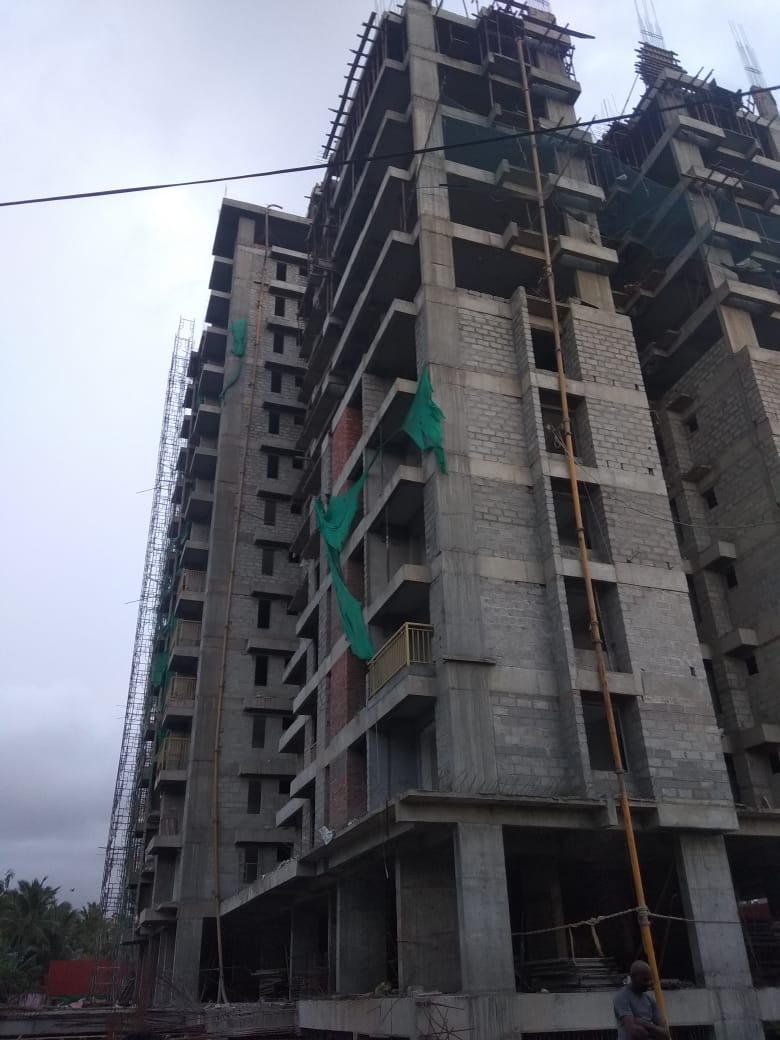

Work status as on 09-02-2021, we have completed the following.
- Earth work & Back filling – 100% completed
- RCC for structure – BF-16th floor -100% completed.
- Ceiling Plastering work – BF to16th floor -100% completed,
- Block work – ,BF-16th floor 100% completed,
- Door frame fixing -1st -15 th floor,terrace floor-100% completed
- Electrical chasing work – 1st floor -16th floor (100% completed).
- Plumbing work -1st -15th floor -100% completed
- Wall plastering work – BF-16th floor (100% completed)
- Dadoing of Toilets:1st -12th floor-100% completed,13th-14th floor :-50% completed.
- Application of putty walls & ceiling :1-16th floor (100%completed)
- Wire pulling : 1st-16th floor -100% completed,
- Water proofing and pressure Grouting work: 1st -14th floor:- 100% completed,15th floor-50% completed
- Flooring and skirting :1st-13th floor:- 100% completed
- Aluminium Windows and Ventilators – 1st -13th floor-50% completed
- Grills &Handrails :1st -15th floor-100% completed.
- Fixing of Doors:1st -9th floor -100% completed
- Grills :-1st -15th floor-100% completed.
- Painting :(1 st coat putty ) -1st -2nd floor (100% completed), 3rd,4th,5th floor :-50% completed.
- DB Dressing & Switch fixing :-1st -9 th floor (50%completed).
- Fire fighting -2 nd floor- 60% completed,BF and GF -work in progress
- H .T WORK:- cable pulling completed.-30% completed.
- Lift Work – 2 Nos erection work on Progressing,2nd completed
- External Plastering Work : 1st – 16th floor -100% completed
- mockup flat -100% completed
As per the current work status from our site, we are targeted to complete the following works by the end of June 2020.
- Ceiling Plastering work – 16th floor-100%to be completed
- Block work -16th floor 50% to be completed.
- Plumbing work – upto 15th floor :-100% to be completed.
- Wall plastering work – upto 14th floor -100% to be completed
- Dadoing of Toilets: 8th -14th -100% to be completed
- Application of putty walls & ceiling :13th – 100% to be completed .,14 th floor :-100% to be completed.
- Water proofing and pressure Grouting work: 11th -14th floor – 100% to be completed.
- Flooring and skirting :9th-12th floor: -90% to be completed.
- Aluminium Windows and Ventilators:-1st floor -7th floor :-20% to be completed.
- Grills &Handrails :upto 12th floor- 90% to be completed.
- DB Dressing & Switch fixing :- upto 12th floor- 50% to be completed.
- Fire fighting -70% to be completed
- H.T work :-20% to be completed.
- Lift Work :- 50% to be completed.
- External Plastering Work : 85% to be completed

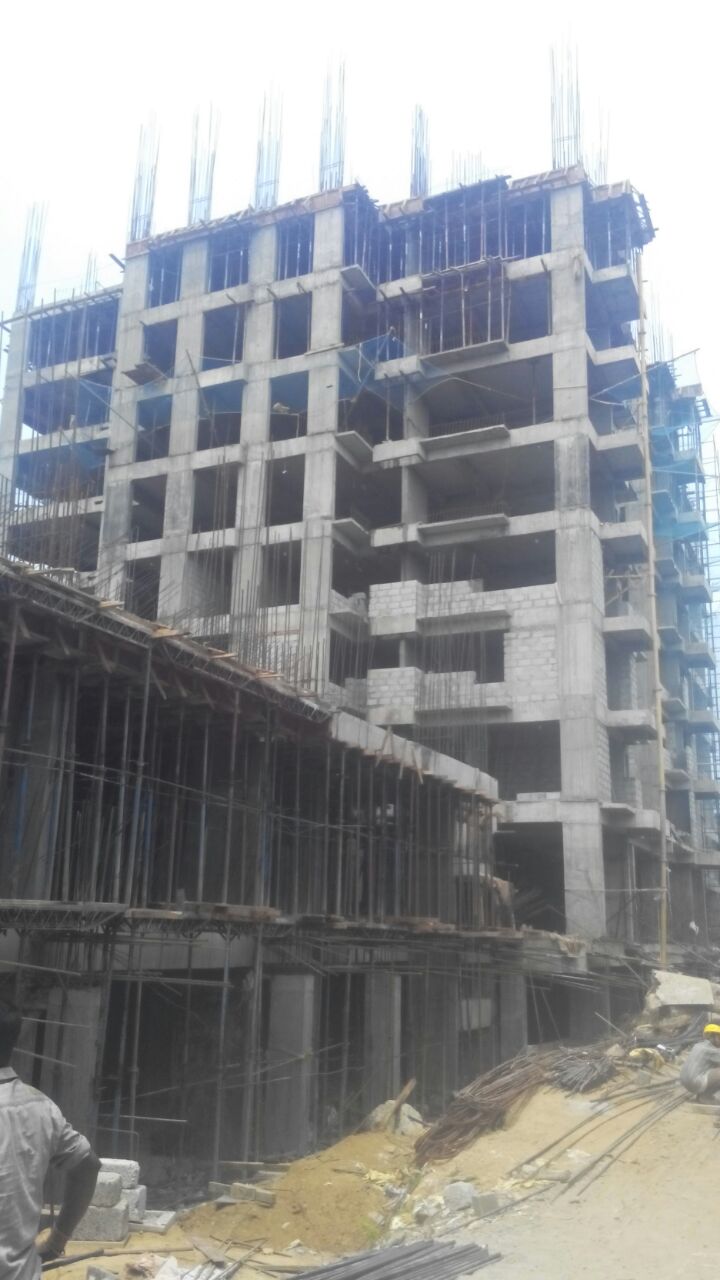

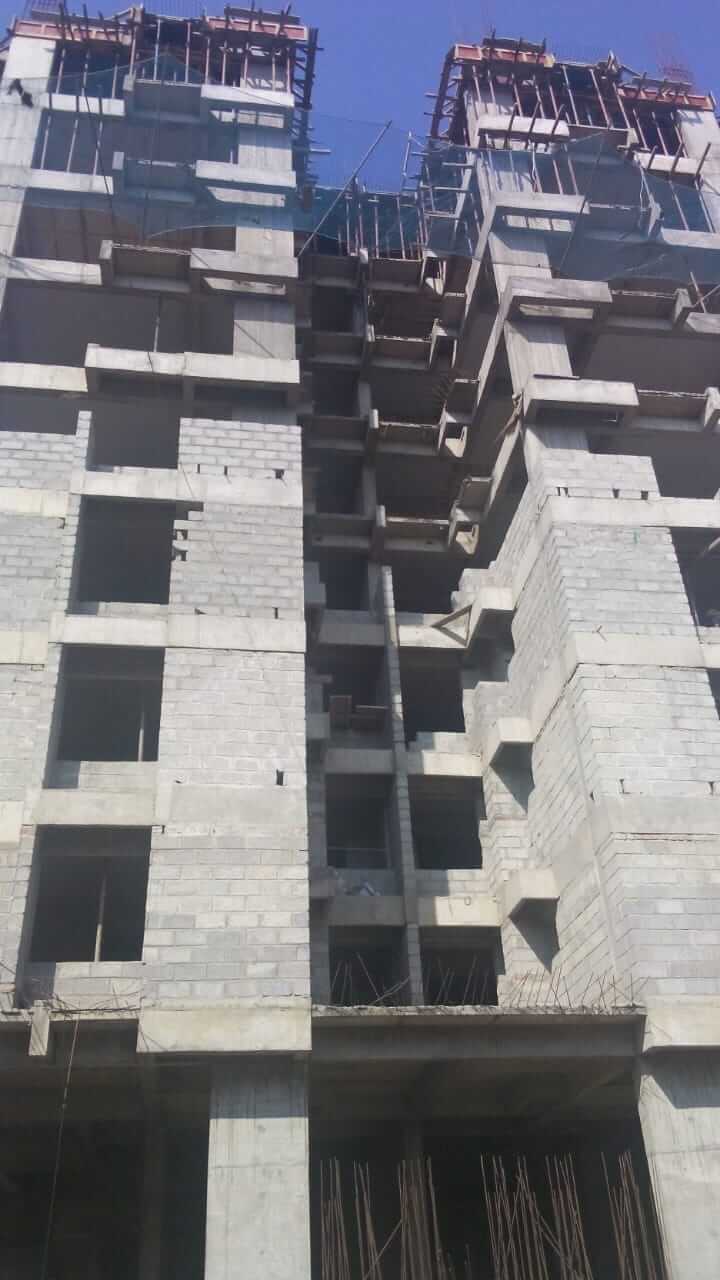

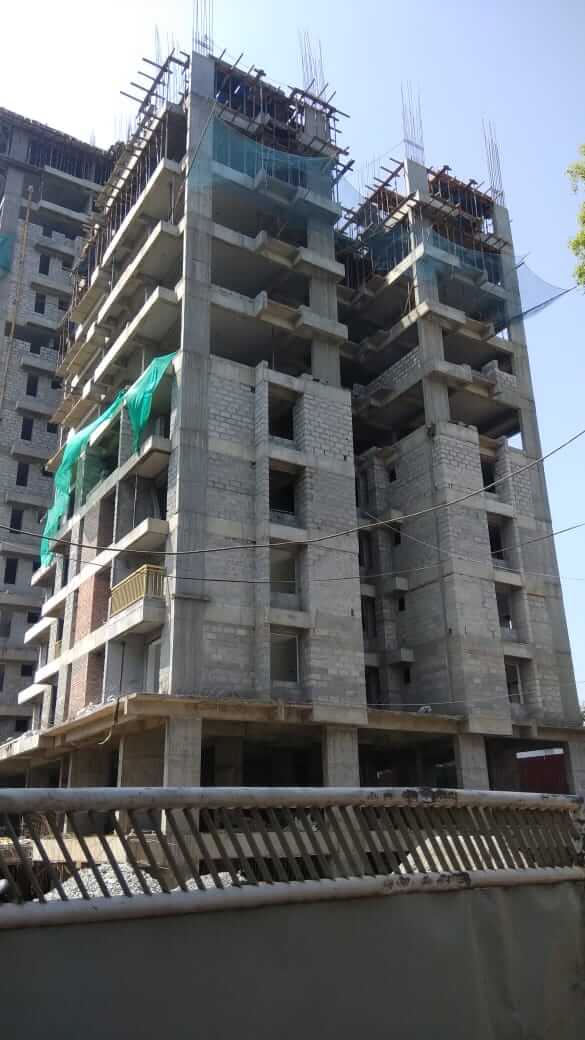

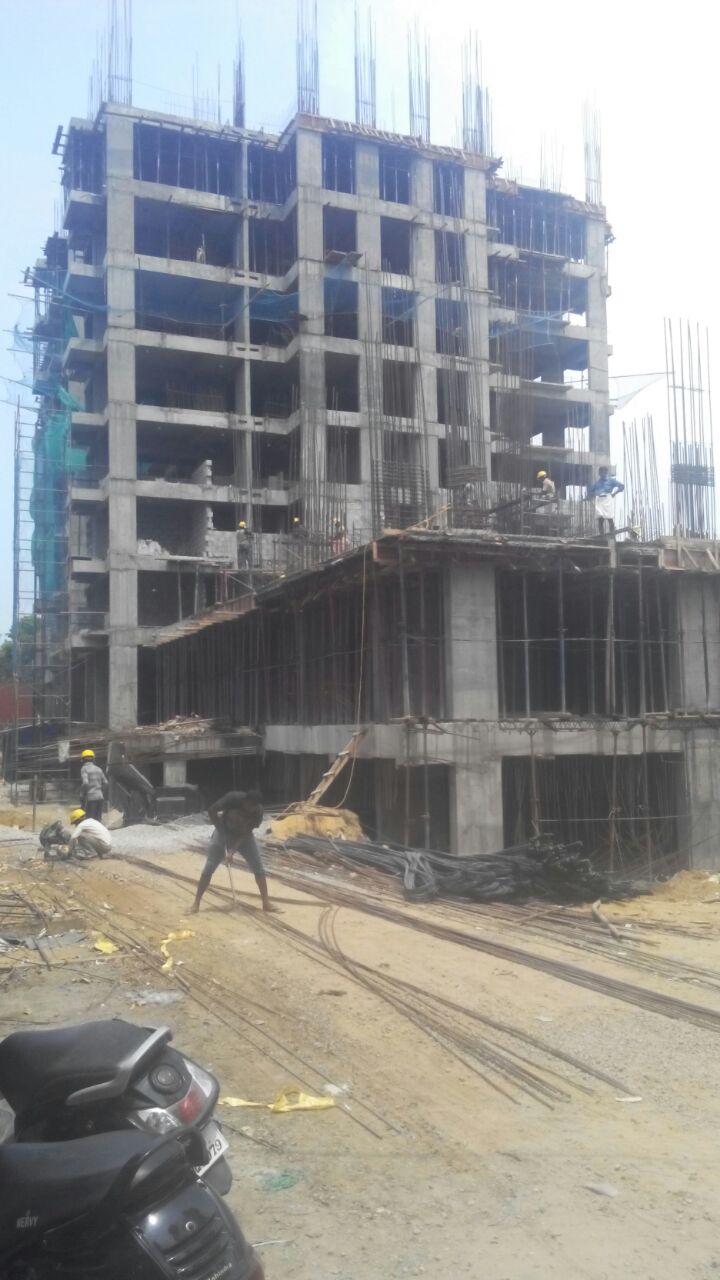

Work status as on 12-06-2020, we have completed the following.
- Earth work & Back filling – 97% completed
- RCC for structure – BF -95% completed, GF-15th floor -100%, 16th floor :-100% completed.
- Ceiling Plastering work – BF & GF (90% completed); 1st to15th floor (100% completed)
- Block work – BF,GF (50% Completed),1-15th floor 100% completed.
- Door frame fixing -1st -14 th floor (100% completed)
- Electrical chasing work – 1st floor -14th floor (100% completed).
- Plumbing work -(1-12th floor )-100% completed, 14 th -75% completed .
- Wall plastering work – 1st to13th floor (100% completed),13-14th -75% completed
- Dadoing of Toilets: 1st-6th floor-100% completed, 7th -9th floor-80% completed,10th-11th floor :-50% completed.
- Application of putty walls & ceiling :1-12th floor (100%completed).-13 th -80% completed ,14th floor:-50% completed.
- Wire pulling : 1st-7th floor -95% completed, 8th-14th floor – 90% completed.
- Waterproofing and pressure Grouting work: 1st -5th floor:- 100% completed,6th-10th floor:- (90% completed),11-14 th floor -70% completed.
- Flooring and skirting :1st-4th floor:- 100% completed,5th- 8th foor:- (90% ) completed,9th-10th floor-50% completed
- Aluminium Windows and Ventilators – 1st – 10th floor-10% completed
- Grills &Handrails :1st -8th floor-90% completed ,9th -12th floor :-30% completed .
- Fixing of Doors:1st -4 th floor -50% completed
- Grills-1st&2nd-90% completed,3rd-8th floor-60% completed,9th-11th floor-50% completed
- Painting :(1 st coat putty ) -2 nd floor (40% completed)
- DB Dressing & Switch fixing :-1st -9 th floor (50%completed).
- Fire fighting -2 nd floor (60% completed)
- H .T WORK:- cable pulling completed.
- Lift Work – 2 Nos errection work on Progressing ,2nd completed
- External Plastering Work : 65% completed
- mock up flat -100% completed
As per the current work status from our site, we are targeted to complete the following works by the end of March 2020.
- RCC for structure – 16th floor 100%to be completed
- Ceiling Plastering work – 15th floor-100%to be completed
- Door frame fixing –13-14 th -100% to be completed.
- Electrical chasing work – upto 14 th -100% to be completed
- Plumbing work – upto 14th floor :-100% to be completed.
- Wall plastering work – upto 14th floor -100% to be completed
- Dadoing of Toilets: 5th -9th -100% to be completed
- Application of putty walls & ceiling :13th – 100% to be completed .,14 th floor :-30% to be completed.
- Waterproofing and pressure Grouting work: 11th -13th floor – 90%,to be completed.
- Flooring and skirting :1-6th floor -100% to be completed,7th-9th -90% to be completed .
- Aluminium Windows and Ventilators:-1st floor -7th floor :-20% to be completed.
- Grills & Handrails :upto 11th floor- 90% to be completed.
- DB Dressing & Switch fixing :- upto 10th floor- 50% to be completed.
- H.T work :-20% to be completed.
- Lift Work :- 50% to be completed.

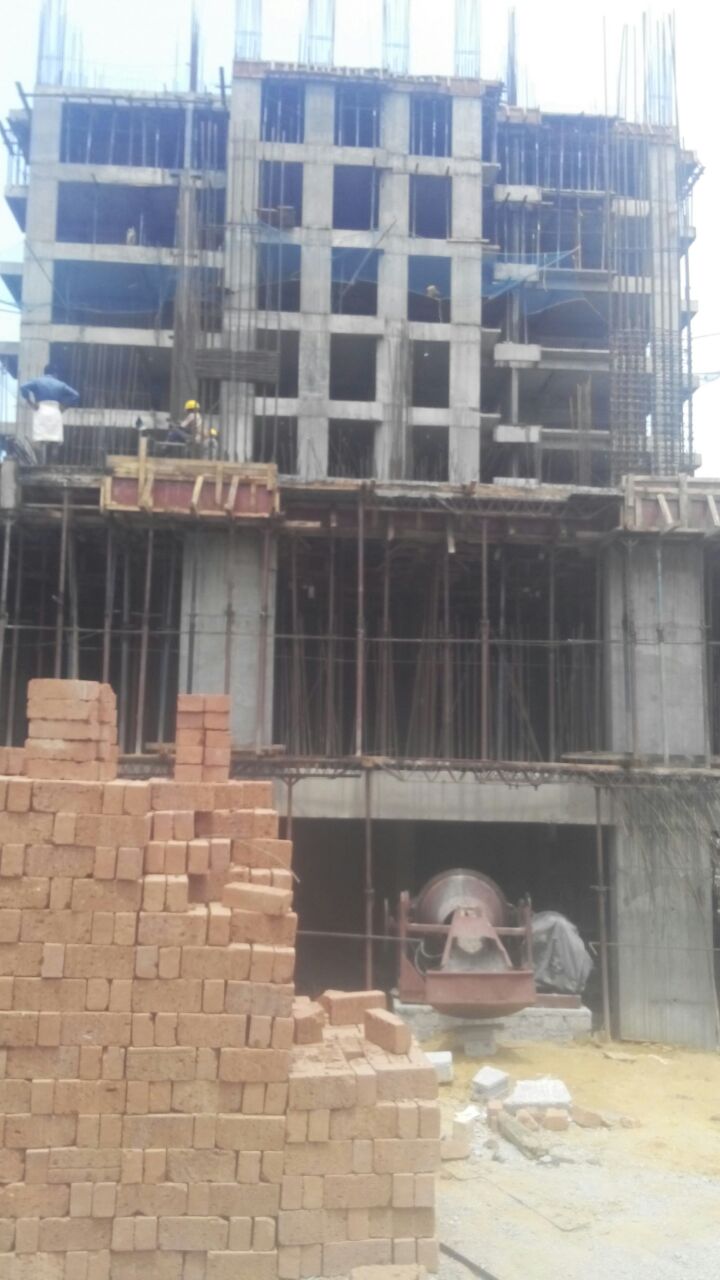

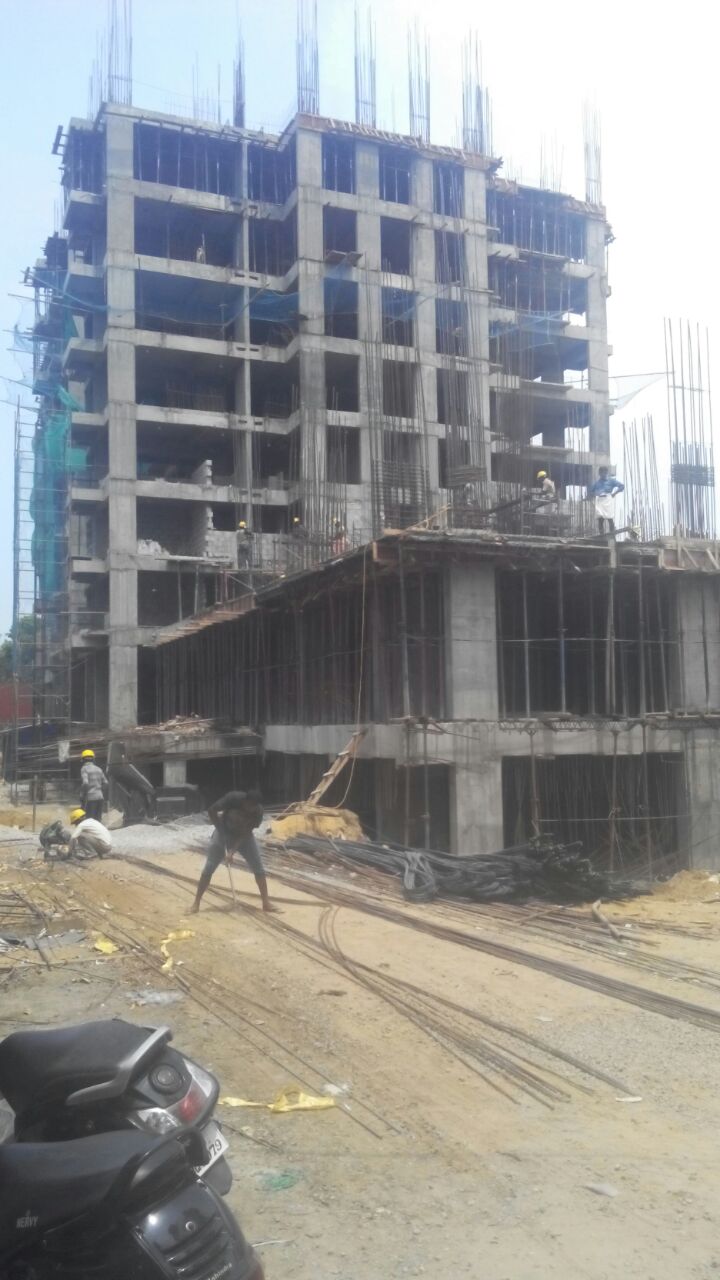

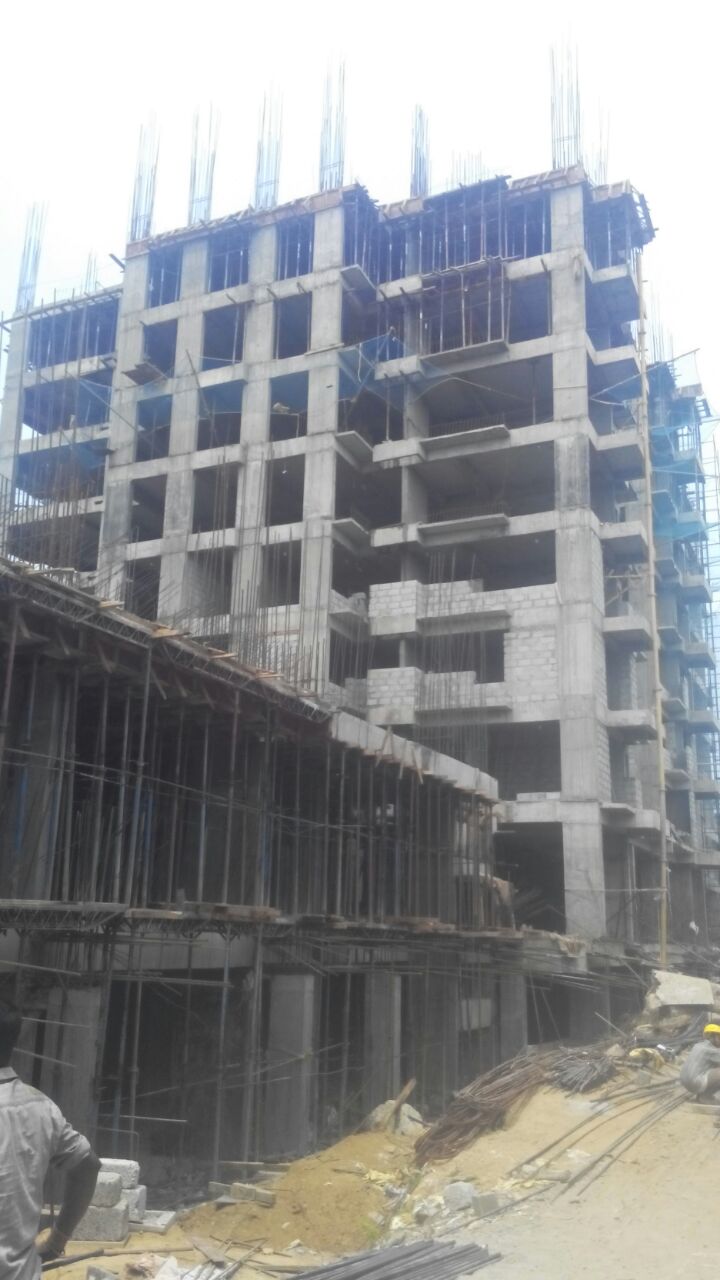

Work status as on 11-03-2020, we have completed the following.
- Earth work Excavation – 100% completed

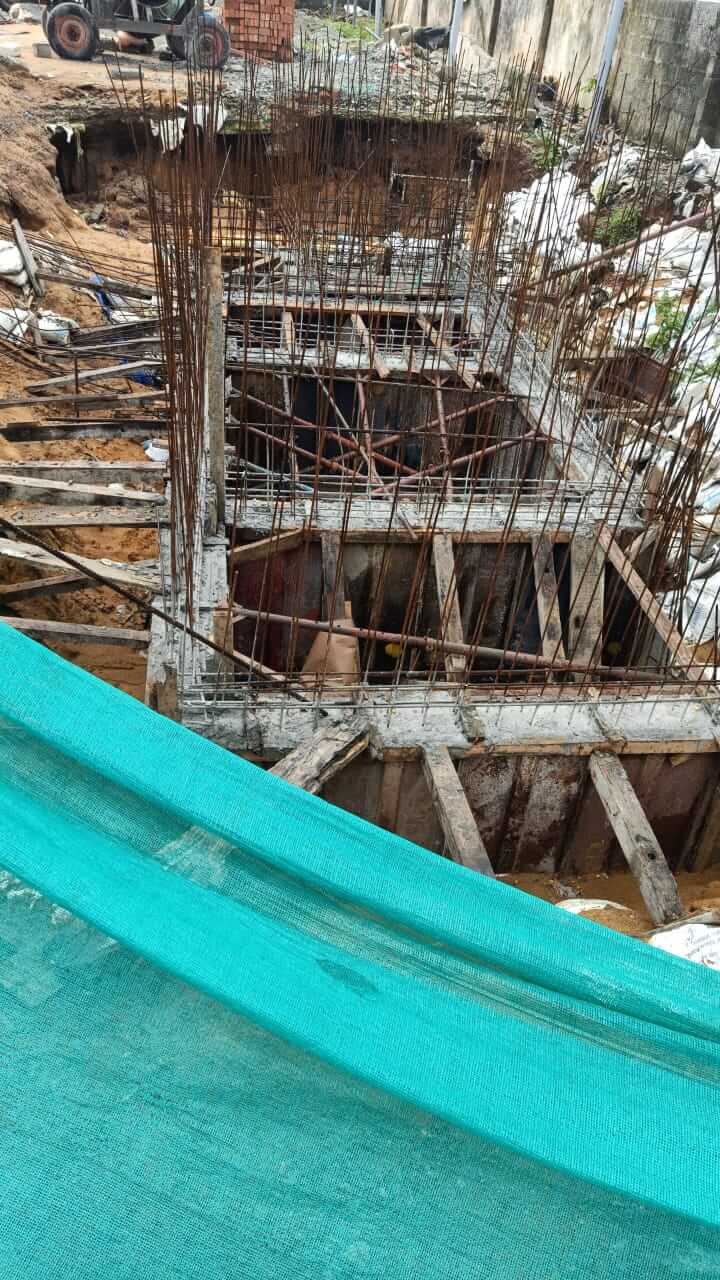

- RCC for Pile cap & Grade beam – 100% completed
- Earth work & Back filling – 97% completed
- RCC for structure – BF -95% completed, GF-15th floor -100%, 16th floor :-80% completed.
- Ceiling Plastering work – BF & GF (80% completed); 1st to14th floor (100% completed); 15th floor (90% completed).
- Block work – BF,GF (50% Completed),1-14th floor 100% completed.
- Door frame fixing -1st -11 th floor (100% completed)
- Electrical chasing work – 1st floor -12th floor (100% completed),13-14 th floor (70% completed).
- Plumbing work -(1-12th floor )-100% completed,13th floor -14 th -75% completed .
- Wall plastering work – 1st to12th floor (100% completed),13-14th -60%completed
- Dadoing of Toilets: 1st-4th floor-100% completed, 5th -9th floor-80% completed.
- Application of putty walls & ceiling :1-12th floor (100%completed).-13 th -80% completed ,14th floor:-50% completed.
- Wire pulling : 1st-13th floor (90% completed)
- Waterproofing and pressure Grouting work: 1st -10th floor (90% completed),11-14 th floor -70% completed.
- Flooring and skirting :1st- 6th (90% ) completed,7th-8th floor-50% completed,9th floor-50% completed.
- Aluminium Windows and Ventilators – 2 nd floor( 20% completed)
- Grills & Handrails :BF,GF(5%completed),1st -8th floor-90% completed ,9th -11th floor -12th floor :-20% completed.
- Fixing of Doors:1st -4 th floor -50% completed
- Grills-1st&2nd-90% completed,3rd-8th floor-60% completed,9th-11th floor-50% completed
- Painting :(1 st coat putty ) -2 nd floor (40% completed)
- DB Dressing & Switch fixing :-1st floor- 60% completed, 2nd -7 th floor (50%completed).
- Fire fighting -2 nd floor (40% completed)
- Lift Work – 2 Nos errection work on Progressing ,2nd completed
- External Plastering Work :55% completed
- Mock up flat -100% completed
As per the current work status from our site, we are targeted to complete the following works by the end of February 2020.
- RCC for structure – 16th floor 100%to be completed
- Ceiling Plastering work -14th & 15th floor-100%to be completed
- Block work -14-15 th -100% to be completed.
- Door frame fixing –12-14 th -100% to be completed.
- Electrical chasing work – 12-14 th -100% to be completed
- Plumbing work -12th floor-100% to be completed, 13th – 14th floor :-75% to be completed.
- Wall plastering work -12-14 -95% to be completed
- Dadoing of Toilets: 5th -10th -90% to be completed
- Application of putty walls & ceiling :11th-13th – 100% to be completed, 14th floor :-30% to be completed.
- Wire pulling : 12th,13th -90%, to be completed.
- Waterproofing and pressure Grouting work: 11th-3th 90%,to be completed.,14th floor: -60% to be completed.
- Flooring and skirting :1-7th floor -80% to be completed,9-11th -60% to be completed.
- Aluminium Windows and Ventilators:-1st floor -6th floor :-5% to be completed.
- Grills & Handrails :1st floor -7thfloor-80% to be completed.,10th floor -13th floor -60% to be completed.
- DB Dressing & Switch fixing :GF -7 th -50% to be completed.
- External Plastering Work :50% to be completed
Work status as on 08-02-2020, we have completed the following.
- Earth work Excavation – 100% completed.
- RCC for Pile cap & Grade beam – 100% completed.
- Earth work & Back filling – 97% completed.
- RCC for structure – BF -95% completed, GF-15th floor -100%, 16th floor :-50% completed.
- Ceiling Plastering work – BF & GF (80% completed); 1st to13th floor (100% completed);14th to 15th floor (75% completed).
- Block work – BF,GF (50% Completed),1- -13th floor 100% completed),14 th floor -75% completed.
- Door frame fixing -1st -11th floor (100% completed).
- Electrical chasing work – 1st floor -11th floor (100% completed),12-14 th floor (75% completed).
- Plumbing work -(1-11th floor )-100% completed,12th floor -14 th -75% completed.
- Wall plastering work – 1st to11th floor (100% completed),12-14th -60%completed.
- Dadoing of Toilets: 1st-9th floor-80% completed.
- Application of putty walls & ceiling :1-9th floor (100%completed).-,10-13 th -80% completed ,14th floor:-30% completed.
- Wire pulling : 1st-11th floor (90% completed),12th-14thfloor -60% completed.
- Waterproofing and pressure Grouting work: 1st -10th floor (90% completed),11-14 th floor -70% completed.
- Flooring and skirting :1st- 6th (90% ) completed,7th-8th floor-50% completed.
- Aluminium Windows and Ventilators – 2 nd floor( 20% completed)
- Grills & Handrails :BF,GF(5%completed),1st floor :-60% completed,2nd floor – 5th floor(90% completed), 6-9th floor(60% ), 11th floor -12th floor :-35% completed.
- Fixing of Doors:1st -4 th floor -50% completed.
- Grills-1st&2nd-90% completed,3rd-8th floor-60% completed,9th-11th floor-50% completed
- Painting :(1 st coat putty ) -2 nd floor (40% completed)
- DB Dressing & Switch fixing :-1st floor- 60% completed, 2nd -7th floor (50%completed).
- Fire fighting -2 nd floor (40% completed)
- Lift Work – 2 Nos erection work on Progressing ,2nd completed
- External Plastering Work :20% completed
- Mock up flat -100% completed
As per the current work status from our site, we are targeted to complete the following works by the end of JANUARY 2020.
- RCC for structure – 16th floor 100%to be completed
- Ceiling Plastering work -13th 15th floor-100%to be completed
- Block work -13-15 th -100% to be completed .
- Door frame fixing –11-14 th -100% to be completed .
- Electrical chasing work – 11-14 th -100% to be completed
- Plumbing work -9th -13th floor-100% to be completed
- Wall plastering work -13-15 -95% to be completed
- Dadoing of Toilets: 8th -11th -80% to be completed
- Application of putty walls & ceiling :12th-14th-80% to be completed .
- Wire pulling : 11th,12th -90%, to be completed..
- Waterproofing and pressure Grouting work: 1-7th 90%, 8th-11 th -90% to be completed .
- Flooring and skirting :1-7th floor -80% to be completed,8,9,10th -60% to be completed .
- Grills & Handrails :1st floor-6th floor (100% to be completed),7-13 -60% to be completed .
- DB Dressing & Switch fixing :1-7 th -50% to be completed
- External Plastering Work :50% to be completed
Work status as on 10-01-2020, we have completed the following.
- Earth work Excavation – 100% completed
- RCC for Pile cap & Grade beam – 100% completed
- Earth work & Back filling – 97% completed
- RCC for structure – BF -95% completed, GF-15th floor -100%
- Ceiling Plastering work – BF & GF (80% completed); 1st to12th floor (100% completed);13th to 15th floor (75% completed)
- Block work – BF,GF (50% Completed),1- -12th floor 100% completed),13-15 th floor -75% completed
- Door frame fixing -1st -11 th floor (100% completed)
- Electrical chasing work – 1st floor -10th floor (100% completed),11-15 th floor (75% completed).
- Plumbing work -(1-8th floor )-100% completed,9th floor -13 th -75% completed .
- Wall plastering work – 1st to11th floor (100% completed),12-14th -60%completed
- Dadoing of Toilets: 1st-7thfloor-80% completed,8th floor-20% completed
- Application of putty walls & ceiling :1-11 th floor (80%completed).-,12,13,14 th -30% completed .
- Wire pulling : 1st-10th floor (100% completed),11th-14thfloor -60% completed .
- Waterproofing and pressure Grouting work: 1-7 th floor (90% completed),8-12 th floor -70% completed.
- Flooring and skirting :1st (70% ) completed,1st-4th floor-80%,5th,6th-50%completed
- Aluminium Windows and Ventilators – 2 nd floor( 20% completed)
- Grills &Handrails :BF,GF(5%completed),1st floor-5thfloor (60% completed),6-8th floor (50% ) ,9-12th (35%)completed .
- Fixing of Doors:1st -4 th floor -50% completed
- Grills-1st&2nd-90% completed,3rd-8th floor-60% completed,9th-11th floor-50% completed
- Painting :(1 st coat putty ) -2 nd floor (40% completed)
- DB Dressing & Switch fixing :1st-6 th floor (30%completed).
- Fire fighting -2 nd floor (40% completed)
- Lift Work – 2 Nos erection work on Progressing
- External Plastering Work :40% completed
- mock up flat -100% completed
As per the current work status from our site we are targeted to complete the following works by end of September 2019
- RCC for structure -15 th floor 95% to be completed
- Ceiling Plastering work -5-10 th floor -100% ,11-12 th floor-95% to be completed
- Block work – 6-8 th floor (90% ),10th -95%,11 th -80% to be completed.
- Door frame fixing -15 th floor (80% to be completed)
- Electrical chasing work – 1st floor -7th floor (100% to be completed),15 th floor -30% to be completed .
- Plumbing work -8& 9 th -70%,10 th -40% to be completed .
- Wall plastering work – 1st to 5th floor (100% to be completed),15 th floor (40% to be completed).
- Water proofing and pressure Grouting work: 7,8 th -90%,9&10 th-75% to be completed
- Flooring and skirting :1-4th floor -70% to be completed.
- Grills &Handrails :1st floor-4th floor (70% to be completed),5 th -50%,6 th -45% ,7-11 th -35% completed .
- DB Dressing & Switch fixing :1stfloor -4 th floor -(40% to be completed),5 th floor -30% to be completed
Work status as on 05.09.2019, we have completed the following
- Earth work Excavation – 97% completed
- RCC for Pile cap & Grade beam – 100% completed
- Earth work & Back filling – 97% completed
- RCC for structure – BF to14th floor (95% completed); ,15 th floor -80%, completed-16 th (40% ) completed.
- Ceiling Plastering work – BF & GF (80% completed); 1st to4th floor (100% completed);5th to 10th floor (95% completed); 11-14th floor (75%)completed,15 th floor -70% completed.
- Block work – BF,GF (50% Completed),1-5th floor (100 % completed), 6 th -8th th floor (75% completed),9 th floor -95% completed,10th-80%,11-14 th floor -75% completed
- Door frame fixing -1st -7 th floor (100% completed);9 th to14th floor (80% completed)
- Electrical chasing work – 1st floor -8th floor (95% completed),9-14 th floor (80% completed).
- Plumbing work -(1-4 th floor )-95% completed,5-7 th floor (70% completed).
- Wall plastering work – 1st to 6th floor (95% completed),7th -9th floor (75 % completed),10th floor -40% completed.
- Dadoing of Toilets: 1st &2nd ,3rdfloor,4 th floor (75%completed),5 th floor -40% completed.
- dadoing of kitchen walls: Ground to Fifth floor -75% completed,
- Application of putty walls & ceiling :1-9 th floor (80%completed).
- Wire pulling : 1st-6th floor (90% completed),7 th &8thfloor (80% completed),9th -30%,10th -20% completed .
- Water proofing and pressure Grouting work: 1-6 th floor (90% completed),7-10 th floor -70% completed.
- Flooring and skirting :1st (40% ),2 nd (70%),3-(50%),4 th -50% completed.
- Aluminium Windows and Ventilators – 2 nd floor( 20% completed)
- Grills &Handrails :BF,GF(5%completed),1st floor-5thfloor (50% completed),6-11 th floor (35% ) completed .
- Fixing of Doors:1st ,2 nd floor -60% to be completed
- Painting :(1 st coat putty ) -2 nd floor (40% completed)
- DB Dressing & Switch fixing :1stfloor -4 th floor -(30% completed)
- Fire fighting -2 nd floor (40% completed)
- Lift Work -on Progressing
- External Plastering Work :20% completed
- mock up flat -100% completed
As per the current work status from our site we are targeted to complete the following works by end of August 2019
- RCC for structure -upto 12 th floor -100% to be completed,16 th floor -60% to be completed.
- Ceiling Plastering work – 1st -11 th -100% to be completed.15 th floor -75% tobe completed.
- Block work – 1-8th floor (100 % completed), 6 th -13th th floor (80% completed),14 th floor -75% completed
- Electrical chasing work – 1st floor -7th floor (100% to be completed)
- Plumbing work -(1-4 ) th floor -100% to be completed
- Wall plastering work – 1st to 5th floor (100% to be completed),15 th floor (40% to be completed).
- Water proofing and pressure Grouting work: 1-5 th floor (100% completed).
- Flooring and skirting :1-4th floor -60% to be completed.
- Grills &Handrails :1st floor-11th floor (50% to completed)
- DB Dressing & Switch fixing :1st-6 th floor (60% to becompleted).
Work status as on 05.08.2019, we have completed the following
-
- Earth work Excavation – 97% completed
- RCC for Pile cap & Grade beam – 100% completed
- Earth work & Back filling – 97% completed
- RCC for structure – BF to13th floor (95% completed); ,14-15 th floor -80% completed-16 th (40% ) completed.
- Ceiling Plastering work – BF & GF (80% completed); 1st to4th floor (100% completed);5th to 8th floor (95% completed); 9-14th floor (75%)completed,15 th floor -70% completed.
- Block work – BF,GF (50% Completed),1-5th floor (100 % completed), 6 th -13th th floor (80% completed),14 th floor -75% completed
- Door frame fixing -1st &5th floor (100% completed);6 th to13th floor (80% completed)
- Electrical chasing work – 1st floor -5th floor (95% completed),6-13 th floor (80% completed),14 th -80% completed.
- Plumbing work -(1-2 nd floor )-90% completed,3-9 th floor (70% completed),10 th floor (40%completed)
- Wall plastering work – 1st to 5th floor (95% completed),8th -13th floor (75 % completed),14 th floor –10% completed.
- Dadoing of Toilets: 1st &2nd ,3rdfloor,4 th floor (75%completed),5 th floor -40% completed.
- dadoing of kitchen walls: Ground to Third floor -60% completed,
- Application of putty walls & ceiling :1-7 th floor (80%completed),,8 th floor -60% completed.
- Wire pulling : 1st-5th floor (90% completed),6 th floor (80% completed),6 th& 8 th -30% completed.
- Water proofing and pressure Grouting work: 1-3rd floor (90% completed)4-10 th floor -70% completed.
- Flooring and skirting :1st (40% ),2 nd (60%),3-(50%),4 th -50% completed.
- Aluminium Windows and Ventilators – 2 nd floor( 20% completed)
- Grills &Handrails :BF,GF(5%completed),1st floor-3 rd floor (50% completed),4-11 th floor (35% ) to be completed .
- Fixing of Doors:1st ,2 nd floor -60% to be completed
- Painting :(1 st coat putty ) -2 nd floor (40% completed)
- DB Dressing & Switch fixing :1stfloor (20% completed),2 nd floor(40% completed),3 rd,4 th floor -(20% completed)
- Fire fighting -2 nd floor (40% completed)
- Lift Work -on Progressing
mock up flat -Block work ,ceiling plastering ,wall plastering ,water proofing for toilets ,application of putty on wall s and ceiling ,door shutter fixing (100% completed),electrical chasing-,wire pulling ,db dressing and switch fixing (100% completed),plumbing (100%completed),dadoing of toilets(100% completed),flooring and fixing aluminium doors and windows (100% completed),grill fixing (100% completed),first coat,second coat painting -100% completed),fire fighting arrangements (100% completed).
As per the current work status from our site we are targeted to complete the following works by end of July 2019
- RCC for structure -12 th -13 th floor -95% to be completeed
- Application of putty walls & ceiling :8 th &9 th floor -60% to be completed.
- Flooring and skirting :5-6 th floor -30% to be completed.
- Grills &Handrails :1st floor-10 th floor (35% to completed)
Work status as on 06.07.2019, we have completed the following
- Earth work Excavation – 97% completed
- RCC for Pile cap & Grade beam – 100% completed
- Earth work & Back filling – 97% completed
- RCC for structure – BF to11th floor (95% completed); ,12-15 th floor -80% completed-16 th (40% ) completed.
- Ceiling Plastering work – BF & GF (80% completed); 1st to9th floor (95% completed);10th to 14th floor (75% completed); 15th floor (50%)completed.
- Block work – BF,GF (50% Completed),1-5 th floor (95 % completed), 6 th -13th th floor (80% completed),14 th floor -70% completed
- Door frame fixing -1st &5th floor (100% completed);6 th to13th floor (80% completed)
- Electrical chasing work – 1st floor -5th floor (95% completed),6-13 th floor (80% completed),14 th -20% completed.
- Plumbing work -(1-2 nd floor )-90% completed,3-9 th floor (70% completed),10 th floor (40%completed)
- Wall plastering work – 1st to 4th floor (95% completed),3rd floor -70% completed,,7 th -12 th floor (75 % completed),13 th floor (40% completed),14 th floor –10% completed.
- Dadoing of Toilets: 1st &2nd ,3rdfloor,4 th floor (70%completed),5 th floor -40%
- Dadoing of kitchen walls: Ground to Third floor -60% completed,
- Application of putty walls & ceiling :1-5 th floor (80%completed),6th,7th floor -60%complteted,8 th floor -30% completed..
- Wire pulling : 1st-4th floor (90% completed),5 th floor (60% completed),6 th -30% completed.
- Water proofing and pressure Grouting work: 1-2 nd floor (90% completed),3rd-7th 70% completed.
- Flooring and skirting :1st &2 nd floor (40% completed),3rd-4 th -50% completed.
- Aluminium Windows and Ventilators – 2 nd floor( 20% completed)
- Grills &Handrails :BF,GF(5%completed),1st floor-10 th floor (20% completed)
- Fixing of Doors:1st ,2 nd floor -60% to be completed
- Painting :(1 st coat putty ) -2 nd floor (40% completed)
- DB Dressing & Switch fixing :1stfloor (10% completed),2 nd floor(40% completed),3 rd floor -(5% completed)
- Fire fighting -2 nd floor (40% completed)
- mock up flat -Block work ,ceiling plastering ,wall plastering ,water proofing for toilets ,application of putty on wall s and ceiling ,door shutter fixing (100% completed),electrical chasing-,wire pulling ,db dressing and switch fixing (100% completed)),plumbing (100%completed),dadoing of toilets(100% completed),flooring and fixing aluminium doors and windows (100% completed),grill fixing (100% completed),first coat,second coat painting -100% completed),fire fighting arrangements (100% completed).
As per the current work status from our site we are targeted to complete the following works by end of June 2019
- RCC for structure – BF to12h floor (95% to be completed),14-16 th floor -80% to be completeed
- Ceiling Plastering work – 10th floor (95% to be completed); 14h &15 th floor (75%)completed.
- Block work – 6 th -95% , 14 th floor -75% to be completed
- Electrical chasing work – 6th floor (95% completed),6-terrace floor (80% to be completed)
- Wall plastering work – -5 th floor (95% to becompleted),13 th floor (75 % to becompleted),
- Dadoing of Toilets: 1st -7 th floor -60% to be completed.
- Application of putty walls & ceiling :1-8th floor -80% to be completed.
- Wire pulling : 6th to 7 th -60% to be completed.
- Water proofing and pressure Grouting work: 1-4 th (90% ),5-8 th (70% to be completed)
- Flooring and skirting :1 st -5 th floor -50% to be completed.
Work status as on 06.06.2019, we have completed the following
- Earth work Excavation – 97% completed
- RCC for Pile cap & Grade beam – 100% completed
- Earth work & Back filling – 97% completed
- RCC for structure – BF to10th floor (95% completed); 11th (80% completed),12 th floor -80% completed,12-15 th floor r-80% completed-16 th (40% ) completed.
- Ceiling Plastering work – BF & GF (80% completed); 1st to9th floor (95% completed);10th to 14th floor (75% completed); 15th floor (50%)completed.
- Block work – BF,GF (50% Completed),1-5 th floor (95 % completed), 6 th -13th th floor (80% completed),14 th floor -50% completed
- Door frame fixing -1st &5th floor (100% completed);6 th to13th floor (80% completed)
- Electrical chasing work – 1st floor -5th floor (95% completed),6-12 th floor (80% completed)
- Plumbing work -(1-2 nd floor )-90% completed,3-9 th floor (70% completed),10 th floor (40%completed)
- Wall plastering work – 1st to 4th floor (95% completed),3rd floor -70% completed,,7 th -12 th floor (75 % completed),13 th floor (40% completed)
- Dadoing of Toilets: 1st &2nd ,3rdfloor,4 th floor (70%completed),5 th floor -40%
- dadoing of kitchen walls: Ground to Third floor -60% completed,
- Application of putty walls & ceiling :1-5 th floor (80%completed),6th,7th floor -60%complteted.
- Wire pulling : 1st-4th floor (90% completed),5 th floor (60% completed),6 th -30% to be completed.
- Water proofing and pressure Grouting work: 1-6th floor (70% completed)
- Flooring and skirting :1st &2 nd floor (40% completed)
- Aluminium Windows and Ventilators – 2 nd floor( 20% completed)
- Grills &Handrails :BF,GF(5%completed),1st floor-(20% completed)2nd floor -30% completed,3rd floor- 5% completed.
- Fixing of Doors:1st ,2 nd floor -60% to be completed
- Painting :(1 st coat putty ) -2 nd floor (40% completed)
- DB Dressing & Switch fixing :1stfloor (10% completed),2 nd floor(40% completed),3 rd floor -(5% completed)
- Fire fighting -2 nd floor (40% completed)
- mock up flat -Block work ,ceiling plastering ,wall plastering ,water proofing for toilets ,application of putty on wall s and ceiling ,door shutter fixing (100% completed),electrical chasing-,wire pulling ,db dressing and switch fixing (100% completed)),plumbing (100%completed),dadoing of toilets(100% completed),flooring and fixing aluminium doors and windows (100% completed),grill fixing (100% completed),first coat,second coat painting -100% completed),fire fighting arrangements (100% completed).
As per the current work status from our site we are targeted to complete the following works by end of May 2019
- Block work – 14 th floor -75% to be completed
- Electrical chasing work -13 th floor (80% completed),14 t h floor-10% to be completed
- Wall plastering work – -13 th floor (80 % to becompleted),14 th floor (10 % to becompleted),
- dadoing of kitchen walls: forth floor -60% to be completed,
- Application of putty walls & ceiling :6th floor -80% to be completed,7 th & 8 th floor -60% to be completed
- Wire pulling : 3rd floor (90% to be completed),6 th floor (60% to be completed)
- Water proofing and pressure Grouting work: 7th floor (70% to be completed)
- Flooring and skirting :1 st &2 nd floor-50% to be completed,3rd floor (30% to be completed)
Work status as on 06.05.2019, we have completed the following
- Earth work Excavation – 97% completed
- RCC for Pile cap & Grade beam – 100% completed
- Earth work & Back filling – 97% completed
- RCC for structure – BF to10th floor (95% completed); 11th (80% completed),12 th floor -80% completed,12-15 th floor r-80% completed-16 th (40% ) completed.
- Ceiling Plastering work – BF & GF (80% completed); 1st to8th floor (95% completed);9th to 13th floor (75% completed); 14 th floor (50%)completed.
- Block work – BF,GF (50% Completed),1-5 th floor (95 % completed), 6 th -13th th floor (80% completed),14 th floor -10% completed
- Door frame fixing -1st &4 th floor (100% completed);5 th to12 th floor (80% completed)
- Electrical chasing work – 1st floor -5th floor (95% completed),6-12 th floor (80% completed)
- Plumbing work -(1-2 nd floor )-90% completed,3-9 th floor (70% completed),10 th floor (40%completed)
- Wall plastering work – 1st to 2nd floor (95% completed),3rd floor -70% completed,,7 th -12 th floor (75 % completed)
- Dadoing of Toilets: 1st &2nd ,3rdfloor,4 th floor (70%completed)
- dadoing of kitchen walls: Ground to Third floor -60% completed,
- Application of putty walls & ceiling :1-5 th floor (80%completed),6th floor -60%complteted.
- Wire pulling : 1st-2 nd floor (90% completed),3-5 th floor (60% completed)
- Water proofing and pressure Grouting work: 1-6th floor (70% completed)
- Flooring and skirting :1st &2 nd floor (40% completed)
- Aluminium Windows and Ventilators – 2 nd floor( 20% completed)
- Grills &Handrails :BF,GF(5%completed),1st floor-(20% completed)2nd floor -30% completed,3rd floor- 5% completed.
- Fixing of Doors:1st ,2 nd floor -60% to be completed
- Painting :(1 st coat putty ) -2 nd floor (40% completed)
- DB Dressing & Switch fixing :1stfloor (10% completed),2 nd floor(40% completed),3 rd floor -(5% completed)
- Fire fighting -2 nd floor (40% completed)
- mock up flat -Block work ,ceiling plastering ,wall plastering ,water proofing for toilets ,application of putty on wall s and ceiling ,door shutter fixing (100% completed),electrical chasing-,wire pulling ,db dressing and switch fixing (100% completed)),plumbing (100%completed),dadoing of toilets(100% completed),flooring and fixing aluminium doors and windows (100% completed),grill fixing (100% completed),first coat,second coat painting -100% completed),fire fighting arrangements (100% completed).
As per the current work status from our site we are targeted to complete the following works by end of April 2019
-
- Ceiling Plastering work – BF & GF (95%to be completed); 1st to10th floor (95% completed);11th floor (90% to be completed); 14 th floor (25%)completed,12-16 th floor (80% to be completed)
- Block work – 1-8 th floor (95 % to be completed), 6 th floor (30% completed),7-15th th floor (80% to be completed)
- Electrical chasing work – 1st floor -5th floor (95% completed);6 th -12 th floor (80% to be completed)
- Dadoing of Toilets:4th,5 th floor (60% to be completed)
- Application of putty walls & ceiling :7th floor -60% to be completed,8 th floor -20% to be completed
- Flooring and skirting :2 nd,3rd,4th floor (60% completed)
- Grills &Handrails :5 th floor -40% to be completed,8 th floor -30% to be completed
Work status as on 05.04.2019, we have completed the following
-
-
-
- Earth work Excavation – 97% completed
- RCC for Pile cap & Grade beam – 100% completed
- Earth work & Back filling – 97% completed
- RCC for structure – BF to10th floor (95% completed); 11th to 15th floor (80% completed),16 th (40% ) completed.
- Ceiling Plastering work – BF & GF (80% completed); 1st to 8th floor (95% completed);9th to 13th floor (75% completed); 14 th floor (25%)completed.
- Block work – BF,GF (50% Completed),1-5 th floor (95 % completed), 6 th floor (30% completed),7-13th th floor (80% completed)
- Door frame fixing -1st &4 th floor (100% completed);5th to 10th floor (80% completed) ,11th floor (40% completed)
- Electrical chasing work – 1st floor – 4th floor (95% completed);5th – 11th floor (80% completed);12th floor (60% completed)
- Plumbing work -(1-2 nd floor )-90% completed,3-5 th floor (70% completed),6-10 th floor (40%completed)
- Wall plastering work – 1st to 4th floor (95% completed),5-6th -80% completed, 7th – 12th floor (75 % completed)
- Dadoing of Toilets: 1st &2nd ,3rdfloor(70%completed)
- Application of putty walls & ceiling :1-2nd floor (95%completed),3rd -4th floor- 80%completed,6th floor -60%complteted,7th floor-40% completed
- Wire pulling : 1st-3 rd floor (60% completed)
- Water proofing and pressure Grouting work: 1-5th floor(80% completed),6 th &7th floor( 75% completed),8 th floor -70%completed,9 th floor-15% completed.
- Flooring and skirting :2 nd floor (20% completed)
- Aluminium Windows and Ventilators – 2 nd floor( 20% completed)
- Grills &Handrails :BF,GF(5%completed),1st floor-(20% completed)2nd floor -30% completed,3rd floor- 5% completed.
- Fixing of Doors:1st ,2 nd floor -60% to be completed
- Painting :(1 st coat putty ) -2 nd floor (40% completed)
- DB Dressing & Switch fixing :1stfloor (10% completed),2 nd floor(40% completed),3 rd floor -(5% completed)
- Fire fighting -2nd floor (40% completed)
- mock up flat -Block work ,ceiling plastering ,wall plastering ,water proofing for toilets ,application of putty on wall s and ceiling ,door shutter fixing (100% completed),electrical chasing-,wire pulling ,db dressing and switch fixing (100% completed)),plumbing (100%completed),dadoing of toilets(100% completed),flooring and fixing aluminium doors and windows (100% completed),grill fixing (100% completed),first coat,second coat painting -100% completed),fire fighting arrangements (100% completed).
-
-
As per the current work status from our site we are targeted to complete the following works by end of March 2019
-
-
-
- Mock up flat -dadoing of toilets(95% to be completed),kitchen wall dadoing -100% to be completed,flooring and fixing aluminium doors and windows (85% to be completed),grill fixing (10% to be completed),first coat painting -100% to be completed),db dressing -30% to be completed
- RCC for structure – 10th floor -95% to be completed
- Application of putty walls & ceiling :5th floor -40% to be completed,8th floor -30% to be completed
- Grills & Handrails :5th floor -40% to be completed,8th floor -30% to be completed
-
-
Work status as on 06-03-2019, we have completed the following
-
-
-
- Earth work Excavation – 97% completed
- RCC for Pile cap & Grade beam – 100% completed
- Earth work & Back filling – 95% completed
- RCC for structure – BF to9th floor (95% completed); 10th to 15th floor (80% completed)
Ceiling Plastering work – BF & GF (80% completed); 1st to7th floor (95% completed);8th to 13th floor (80% completed); - Block work – 1st to 3rd floor (95% completed),4-11 th th floor (80%)
- Door frame fixing -1st & 2nd floor (95% completed);3rd to 10th floor (80% completed)
- Electrical chasing work – 1st floor to 3rd (95% completed); 4th-9th (90% completed ),9th floor – 80% completed,10th&11 th floor (70%completed)
- Plumbing work -1st floor – 4th floor (80% completed);5th floor(70%),6 floor -50%completed,7th-8th floor -30%completed,9 th -20% completed
- Wall plastering work – 1st to 3rd floor (95% completed);3rd(85%completed)-4th floor ( 90% completed); 5th -9th floor (80% completed);10th floor(20% completed)
- Dadoing of Toilets: 1st &2nd ,3rd floor(70%completed)
- Application of putty walls & ceiling :1-2nd floor (95%completed),3rd -4th floor- 80%completed,6th floor -60% completed, 7th floor-40% completed
- Wire pulling : 1st floor (20% completed),2nd floor -(95% completed),3rd -(10%completed)
- Waterproofing and pressure Grouting work: 1-5th floor(80% completed),6th &7th floor( 75% completed),8th floor -70%completed,9th floor-15% completed.
- Flooring and skirting :2nd floor (20% completed)
- Aluminium Windows and Ventilators – 2nd floor( 20% completed)
- Grills & Handrails :BF,GF(5%completed),1st floor-(20% completed)2nd floor -30% completed,3rd floor- 5% completed.
- Painting :(1 st coat putty ) -2 nd floor (40% completed)
- DB Dressing & Switch fixing :1stfloor (10% completed),2nd floor(40% completed),3 rd floor -(5% completed)
- Fire fighting -2 nd floor (40% completed)
- Mock up flat -Block work ,ceiling plastering ,wall plastering ,water proofing for toilets ,application of putty on wall s and ceiling ,door shutter fixing (100% completed),electrical chasing-95% completed,wire pulling (80% completed),db dressing and switch fixing (10% completed)),plumbing (60% completed), dadoing of toilets(85% completed),flooring and fixing aluminium doors and windows (85% completed),grill fixing (10% completed),first coat painting -40% completed),fire fighting arrangements (95% completed).
-
-
As per the current work status from our site we are targeted to complete the following works by end of February 2019
-
-
-
- Ceiling Plastering work – 14th floor (50%to be completed);
- Wall plastering work – 10 th floor (30% to be completed),11th floor (20% to be completed).
- Dadoing of Toilets: 1st &2nd floor(60% tobe completed),3&4th -50% to be completed.
- Application of putty walls & ceiling :5th floor (50% to becompleted)
- Wire pulling : 2nd floor 20% to be completed,3rd &4th 30% to be completed.
- Water proofing and pressure Grouting work: 1-6th floor(80% completed),6 th &7th floor(75% completed)
- Flooring and skirting :1st&2nd floor (30% to be completed)
- Aluminium Windows and Ventilators -1st&2nd floor (30% to be completed)
- Grills &Handrails :2ndfloor(40% to becompleted )and 2nd floor(30% to becompleted)
- DB Dressing & Switch fixing : 1st and 2 nd floor (30% to be completed)
-
-
Work status as on 05-02-2019, we have completed the following
-
-
-
- Earth work Excavation – 96% completed
- RCC for Pile cap & Grade beam – 100% completed
- Earth work & Back filling – 95% completed
- RCC for structure – BF to 8th floor (95% completed); 9th to 14th floor (80% completed); 15th floor (30% completed)
- Ceiling Plastering work – BF & GF (80% completed); 1st to7th floor (95% completed);8th to 13th floor (80% completed);
- Block work – 1st to 11th floor (80% completed),12 th floor (40%)
- Door frame fixing -1st &2 ndfloor (95% completed);3rd to10 th floor (80% completed)
- Electrical chasing work – 1st floor to 3rd (95% completed); 4th to 9th floor – 80% completed,10th&11 th floor (70%completed)
- Plumbing work -1st floor – 4th floor (80% completed);5 th floor(70%),6-8th floor -80%completed,9 th floor -50%completed,10 th floor -10%completed.
- Wall plastering work – 1st to 2nd floor (95% completed);3rd(85%completed)-4th floor (80% completed); 5th floor (70% completed);6th floor-8th floor(80% completed),9th floor(50%completed);10 th floor (10%completed).
- Dadoing of Toilets: 1st &2nd floor(50%completed)
- Application of putty walls & ceiling :1-2nd floor (95%completed),3rd -4th floor- 80%completed,6th floor -50%complteted,7th floor-25% completed
- Wire pulling : 1st floor 20% completed.
- Water proofing and pressure Grouting work: 1-6th floor(80% completed),6 th &7th floor( 75% completed)
- Flooring and skirting :2 nd floor (20% completed)
- Aluminium Windows and Ventilators – 2 nd floor( 20% completed)
- Grills &Handrails :BF,GF,1st,3 rd floor(5%completed),2nd floor -20% completed,3rd floor- 30% completed.
- Painting :(1 st coat putty ) -2 nd floor (40% completed)
- DB Dressing & Switch fixing :2 nd floor (10% completed)
-
-
As per the current work status from our site we are targeted to complete the following works by end of Janauary 2019
-
-
-
- RCC for structure 9th to 10th floor (95 to becompleted); 15th floor (80% to becompleted)
- Block work – GF to 4th floor -95%to be completed.
- Door frame fixing -1st floor to 4 th floor -95% to be completed
- Dadoing of Toilets:1 st to 3rd floor -60% to be completed
- Application of putty walls & ceiling :5th floor (80% to becompleted),6 th floor- 50% to be completed,7th floor-50%to be completed
- Wire pulling : 1st floor and 2nd floor 40% to be completed.
- Water proofing and pressure Grouting work: 3rd floor to5 th floor (80% to be completed),6 th and 7th floor 20% to be completed
- Flooring and skirting : 1st and 2 nd floor (40% to be completed)
- Grills &Handrails :1 st and 2nd floor(60% to becompleted)
- DB Dressing & Switch fixing : 1st and 2 nd floor (30% to be completed)
-
-
Work status as on 08-01-2019, we have completed the following
-
-
-
- Earth work Excavation – 96% completed
- RCC for Pile cap & Grade beam – 95% completed
- Earth work & Back filling – 90% completed
- RCC for structure – BF to 7th floor (95% completed); 8th to 13th floor (80% completed); 14th floor (80% completed)
- Ceiling Plastering work – BF & GF (80% completed); 1st to 6th floor (95% completed); 7th to 12th floor (80% completed); 13th floor (75% completed)
- Block work – 1st to 12th floor (80% completed)
- Door frame fixing -1st floor (80% completed); 2nd to7 th floor (40% completed)
- Electrical chasing work – 1st floor to 3rd (95% completed); 4th to 9th floor – 80% completed.
- Plumbing work -1st floor – 4th floor (80% completed);5 th floor(70%)-8th floor -50%completed
- Wall plastering work – 1st to 2nd floor (95% completed);3-4th floor (80% completed); 5th floor (70% completed);6th floor(80% completed),7th floor(75%completed);8 th floor (70%completed),9 th floor-40% completed.
- Dadoing of Toilets: 2nd floor(25%completed)
- Application of putty walls & ceiling :1-4 th floor (80%completed),6 th floor- 10%completed,7th floor-5% completed

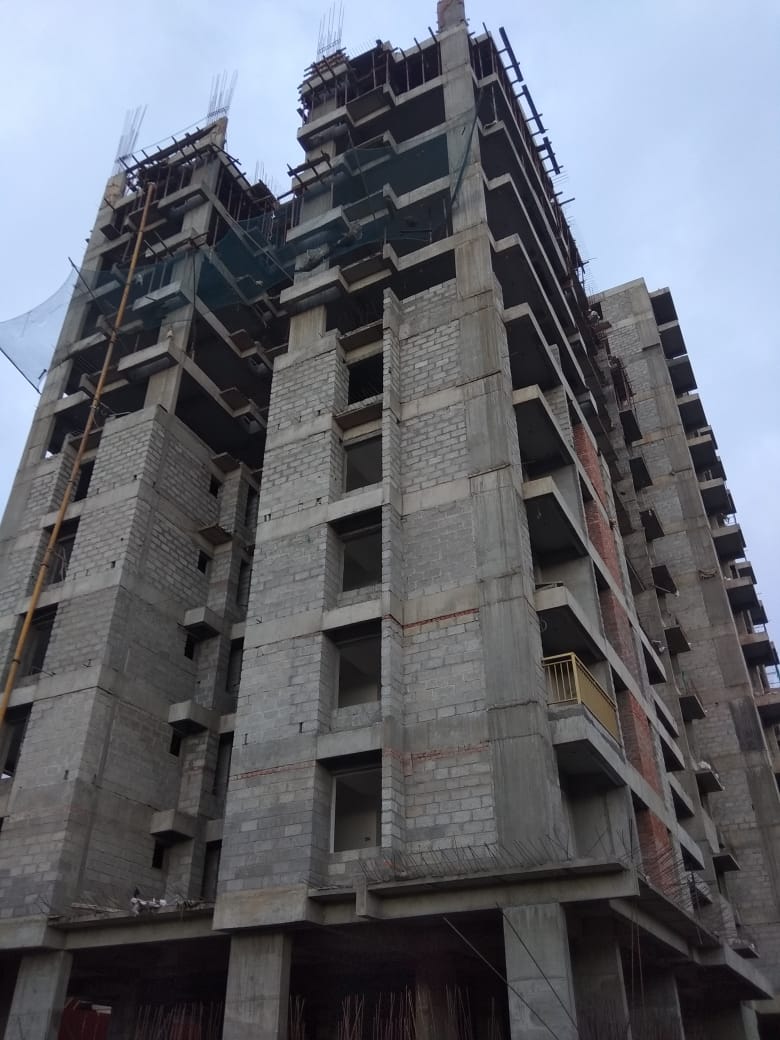

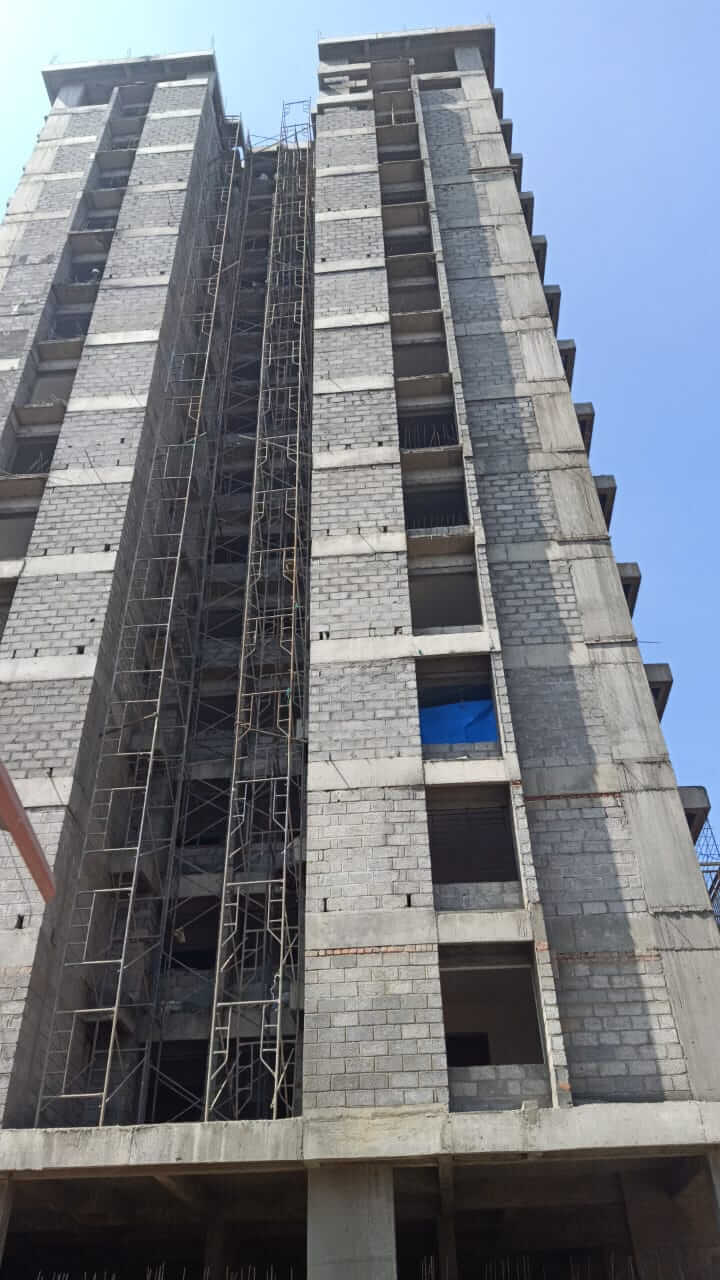

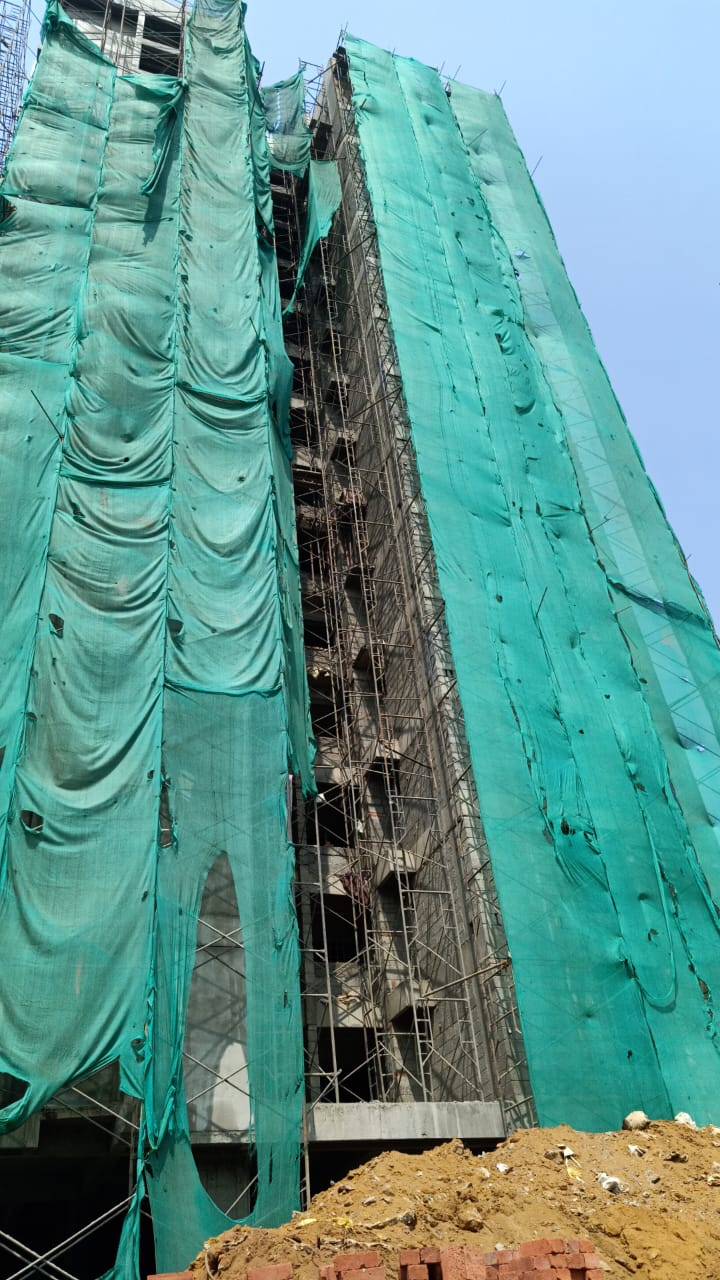

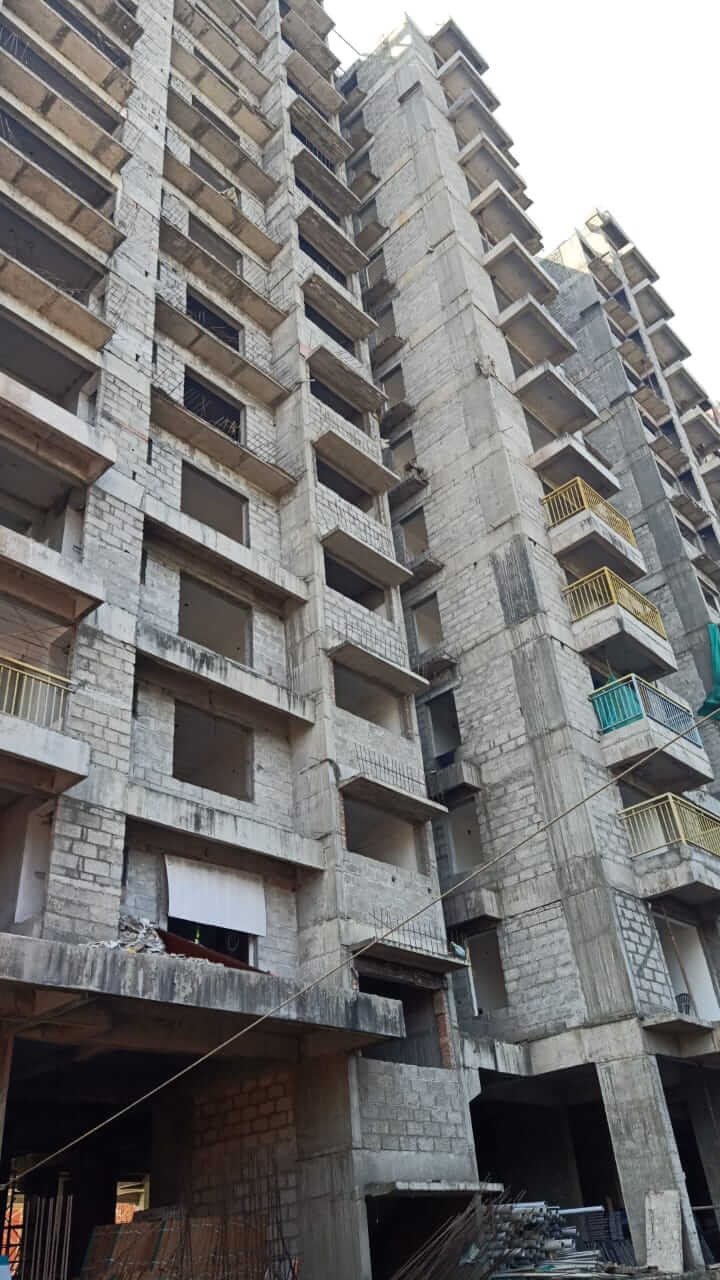

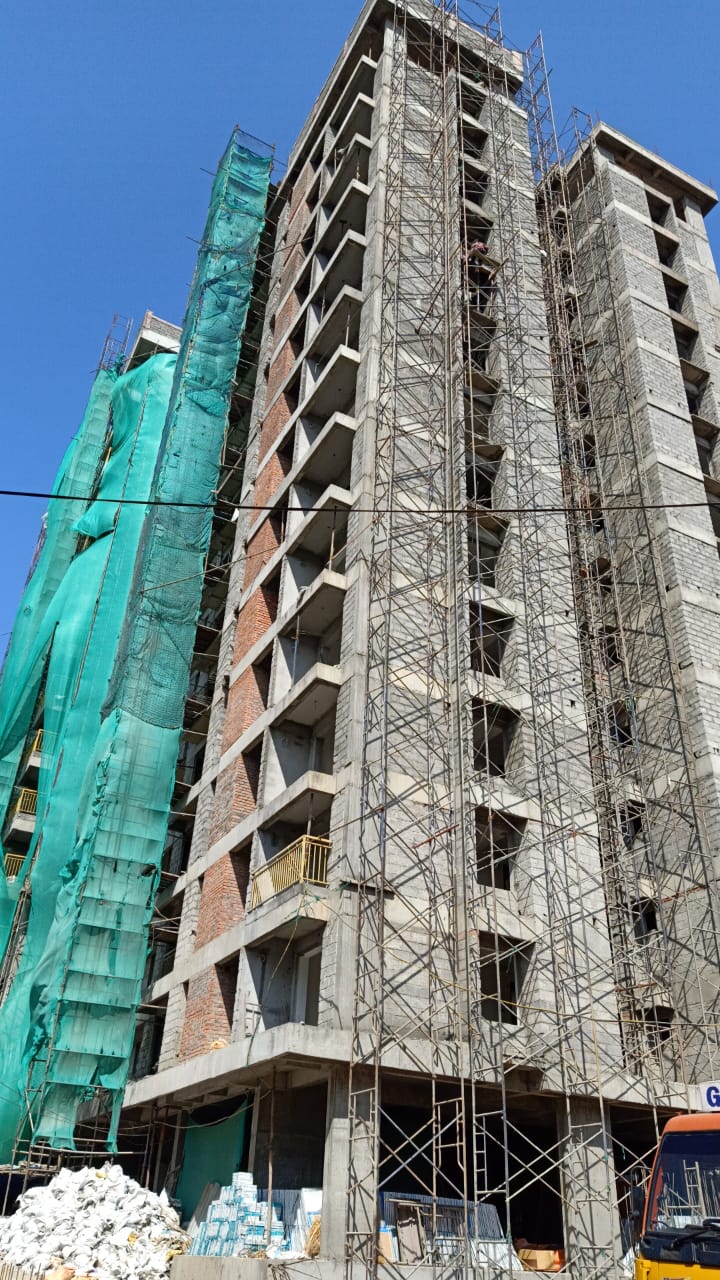

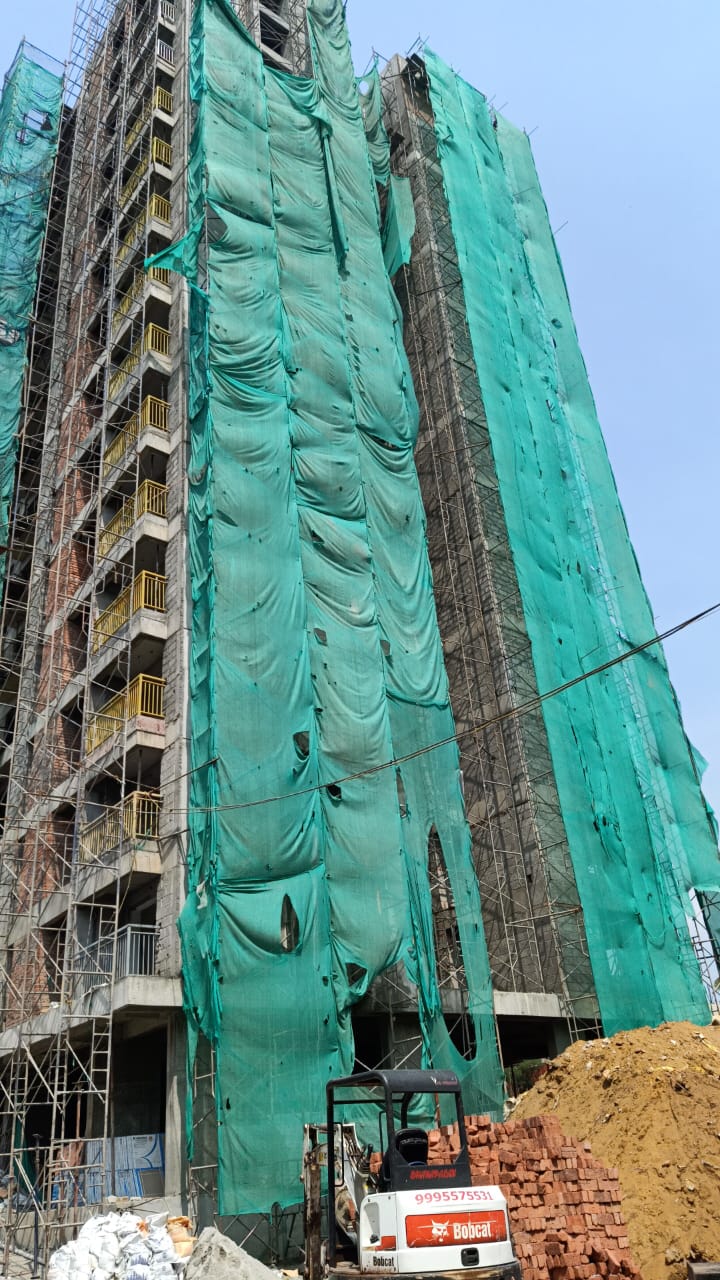

- Wire pulling : 1st floor 20% completed.
- Water proofing and pressure Grouting work: 1-2 nd floor(80% completed),3rd floor( 65% completed),4 th floor (60% completed),5 th floor (20% completed)
- Flooring and skirting :2 nd floor (20% completed)
- Aluminium Windows and Ventilators – 2 nd floor( 20% completed)
- Grills &Handrails :BF,GF,1st,3 rd floor(5%completed),2nd floor -20% completed.
- Painting :1 st coat -2 nd floor (40% completed)
- DB Dressing & Switch fixing :2 nd floor (10% completed)
-
-
As per the current work status from our site we are targeted to complete the following works by end of December 2019
-
-
-
- Door Frame fixing :9 &12 th -20% to be completed,10&11 -80% to be completed.
- Plumbing work -5th floor – 50% to be completed,6 th floor -30% to be completed.
- Wire pulling : 2nd floor 20% to be completed.
- Water proofing and pressure Grouting wo:,3rd floor( 75% to becompleted),4 th floor (70%to be completed),6th floor (60% completed)
- Grills &Handrails :2nd floor(20% to becompleted)
-
-
Work status as on 06-12-2018, we have completed the following
-
-
-
- Earth work Excavation – 96% completed
- RCC for Pile cap & Grade beam – 95% completed
- Earth work & Back filling – 90% completed
- RCC for structure – BF to 7th floor (95% completed); 8th to 13th floor (80% completed); 14th floor (80% completed)
- Ceiling Plastering work – BF & GF (80% completed); 1st to 4th floor (95% completed); 5th to 11th floor (80% completed); 12th floor (20% completed)
- Block work – 1st to 9th floor (80% completed); 10th floor (60% completed); 11th floor (30% completed)
- Door frame fixing -1st floor (80% completed); 2nd & 3rd floor (40% completed); 4th floor (20% completed); 5th floor (40% completed); 7th floor (30% completed),8 th floor(20%)
- Electrical chasing work – 1st floor (95% completed); 2nd to 6th floor – 80% completed; 7th floor (30% completed);8 th floor (20%completed)
- Plumbing work -1st floor – 70% completed; 2nd floor (70% completed; 3rd floor (55% completed); 4th floor (30% completed);5 th floor(30%)
- Wall plastering work – 1st to 2nd floor (95% completed);3-4th floor (80% completed); 5th floor (60% completed);6th floor(80% completed),7th floor(50%completed);8 th floor (30%completed).
- Dadoing of Toilets: 2nd floor(20%completed)
- Application of putty walls & ceiling :1-3rd floor (80%completed),4 th floor- 50%completed.
- Wire pulling : 1st floor 10% completed.
- Water proofing and pressure Grouting work: 1-2 nd floor(80% completed),3rd floor( 65% completed),4 th floor (60% completed),5 th floor (20% completed)
- Flooring and skirting :2 nd floor (20% completed)
- Aluminium Windows and Ventilators – 2 nd floor( 20% completed)
- Grills &Handrails :BF-3 rd floor(5%completed)
- Painting :1 st coat -2 nd floor (40% completed)
- DB Dressing & Switch fixing :2 nd floor (10% completed)
-
-
As per the current work status from our site we are targeted to complete the following works by end of November 2018
-
-
-
- Earth work Excavation – 100% to be completed
- RCC for Pile cap & Grade beam – 100% to be completed
- Earth work & Back filling – 100% to be completed
- RCC for Structure – 14th floor – 100% to be completed
- Ceiling Plastering work – 12th floor – 100% to be completed
- Block work – 9th to 11th floor – 100% to be completed
- Door frame fixing – 6th floor – 100% to be completed
- Electrical chasing work – 6th & 7th floor – 80% to be completed
- Plumbing work -4th & 5th floor – 100% to be completed
- Wall plastering work – 5th and 6th floor – 100% to be completed
-
-
Work status as on 16 -11-2018, we have completed.
-
-
-
- Earth work Excavation – 95% completed
- RCC for Pile cap & Grade beam – 95% completed
- Earth work & Back filling – 90% completed
- RCC for structure – BF to 7th floor (95% completed); 8th to 13th floor (80% completed); 14th floor (40% completed)
- Ceiling Plastering work – BF & GF (80% completed); 1st to 4th floor (95% completed); 5th to 10th floor (80% completed); 11th floor (60% completed)
- Block work – 1st to 8th floor (80% completed); 9th floor (50% completed); 10th floor (5% completed)
- Door frame fixing -1st floor (80% completed); 2nd & 3rd floor (40% completed); 4th floor (20% completed); 5th floor (40% completed); 6th floor (5% completed)
- Electrical chasing work – 1st floor (95% completed); 2nd to 5th floor – 80% completed; 6th floor (40% completed)
- Plumbing work -1st floor – 10% completed; 2nd floor (70% completed; 3rd floor (55% completed); 4th floor (60% completed)
- Wall plastering work – 1st to 3rd floor (80% completed); 4th floor (60% completed); 5th & 6th floor (50% completed)
-
-
-
-
-
- Earth work Excavation – 95% completed
- RCC for Pile cap & Grade beam – 95% completed
- Earth work & Back filling – 90% completed
- RCC for structure – BF to 2nd floor (95% completed); 3rd to 9th floor (80% completed); 10nth floor (40% completed)
- Ceiling Plastering work – BF to 6th floor – 80% completed
- Block work – 1st to 3rd floor (80% completed); 4th floor (50% completed)
- Door frame fixing -1st floor – 70% completed
- Electrical chasing work – 1st to 3rd floor – 80% completed
- Plumbing work -1st floor – 10% completed
- Wall plastering work – 1st floor (65% completed); 2nd floor (25% completed)
-
-
As per the current work status from our site we are targeted to complete the following works by end of June 2018
-
-
-
- Earth work Excavation – 100% to be completed
- RCC for Pile cap & Grade beam – 100% to be completed
- Earth work & Back filling – 100% to be completed
- RCC for Structure – 10nth floor – 100% to be completed
- Ceiling Plastering work – 6th floor -100% to be completed
- Block work – 4th floor – 100% to be completed
- Door frame fixing – 1st floor – 100% to be completed
- Electrical chasing work – 3rd floor – 100% to be completed
- Plumbing work – 100% to be completed
- Wall plastering work – 1st floor -100% to be completed
-
-
As per the current work status from our site we are targeted to complete the following works by end of April 2018
-
-
-
- Earth work Excavation – 100% to be completed
- RCC for Pile cap & Grade beam – 100% to be completed
- Earth work & Back filling – 100% to be completed
- RCC for Structure – 100% to be completed
- Ceiling Plastering work – 1st & 2nd floor -100% to be completed
- Block work – 100% to be completed
- Door frame fixing – 100% to be completed
- Electrical chasing work – 100% to be completed
- Plumbing work -100% to be completed
- Wall plastering work – 1st floor -100% to be completed
-
-
Work status as on 1 9 -0 4-2018, we have completed.
-
-
-
- Earth work Excavation – 95% completed
- RCC for Pile cap & Grade beam – 95% completed
- Earth work & Back filling – 90% completed
- RCC for structure – BF & GF (95% completed); 1st to 8th floor(80% completed);9th floor (10% completed)
- Ceiling Plastering work – 1st & 2nd floor (90% completed);BF,GF,3rd, 4th & 5th floor (80% completed)
- Block work – 1st floor (80% completed);2nd floor (75% completed); 3rd floor (70% completed)
- Door frame fixing -1st floor (55% completed)
- Electrical chasing work – 1st floor (65% completed); 2nd floor (20% completed)
- Plumbing work -1st floor (10% completed)
- Wall plastering work – 1st floor (35% completed)
-
-
As per the current work status from our site we are targeted to complete the following works by end of March 2018
-
-
-
- Earth work Excavation – 100% to be completed
- RCC for Pile cap & Grade beam – 100% to be completed
- Earth work & Back filling – 100% to be completed
- RCC for Structure – 100% to be completed
- Block work – 100% to be completed
- Ceiling Plastering work – 1st & 2nd floor -100% to be completed
- Wall plastering work – 1st floor -100% to be completed
- Electrical chasing work – 100% to be completed
- Door frame fixing -1st floor – 100% to be completed
- Plumbing work -1st floor -100% to be completed
-
-
Work status as on 1 3 -0 3 -2018, we have completed.
-
-
-
- Earth work Excavation – 95% completed
- RCC for Pile cap & Grade beam – 95% completed
- Earth work & Back filling – 90% completed
- RCC for structure – BF to 7th floor(80% completed)
- Block work – 1st floor (80% completed);2nd,3rd floor (65% completed)
- Ceiling Plastering work – 1st & 2nd floor (90% completed);BF,GF,3rd & 4th floor (80% completed)
- Wall plastering work – 1st floor (20% completed)
- Electrical chasing work – 1st floor (30% completed)
- Door frame fixing -1st floor (40% completed)
- Plumbing work -1st floor (10% completed)
-
-
-
-
- As per the current work status from our site we are targeted to complete the following works by end of February 2018.
-
-
-
-
-
- Earth work Excavation – 100% to be completed
- RCC for Pile cap & Grade beam – 100% to be completed
- Earth work & Back filling – 100% to be completed
- RCC for Structure – 100% to be completed
- Ceiling Plastering work – 1st & 2nd floor -100% to be completed
- Block work – 100% to be completed
- Door frame fixing -1st floor – 100% to be completed
- Electrical chasing work – 100% to be completed
-
-
Work status as on 10-0 2 -2018, we have completed.
-
-
-
- Earth work Excavation – 90% completed
- RCC for Pile cap & Grade beam – 90% completed
- Earth work & Back filling – 80% completed
- RCC for structure – BF & GF(80% completed);1st,2nd & 3rd floor (75% completed);4th& 5th floor(70% completed);6th floor(40% completed)
- Ceiling Plastering work – 1st & 2nd floor (90% completed);3rd floor (20% completed)
- Block work – 1st floor (70% completed);2nd floor (20% completed)
- Door frame fixing -1st floor – 16% completed
- Electrical chasing work – 1st floor (25% completed)
-
-
-
-
- Work status as on 10-8-2017, we have completed the following.
-
- Piling work – completed
- Pile cap work – progressing
- BF – column work – progressing
- GF column work – progressing
-
-
-
-
- Work status as on 9-6-2017, we have completed the following.
-
- Pile cap work -progressing
- BF – column work – progressing
-
-
-
-
- Work status as on 10-5-2017, we have completed the following.
-
- Piling work – completed
- Pile cap work – progressing
-
-
-
-
- Work status as on 8-3-2017, we have completed the following.
-
- Piling work – completed
- Pile cap work – progressing
- BF – column work -progressing
-
-
-
- As per the current work status from our site we are targeted to complete the following works by end of March, 2017.
