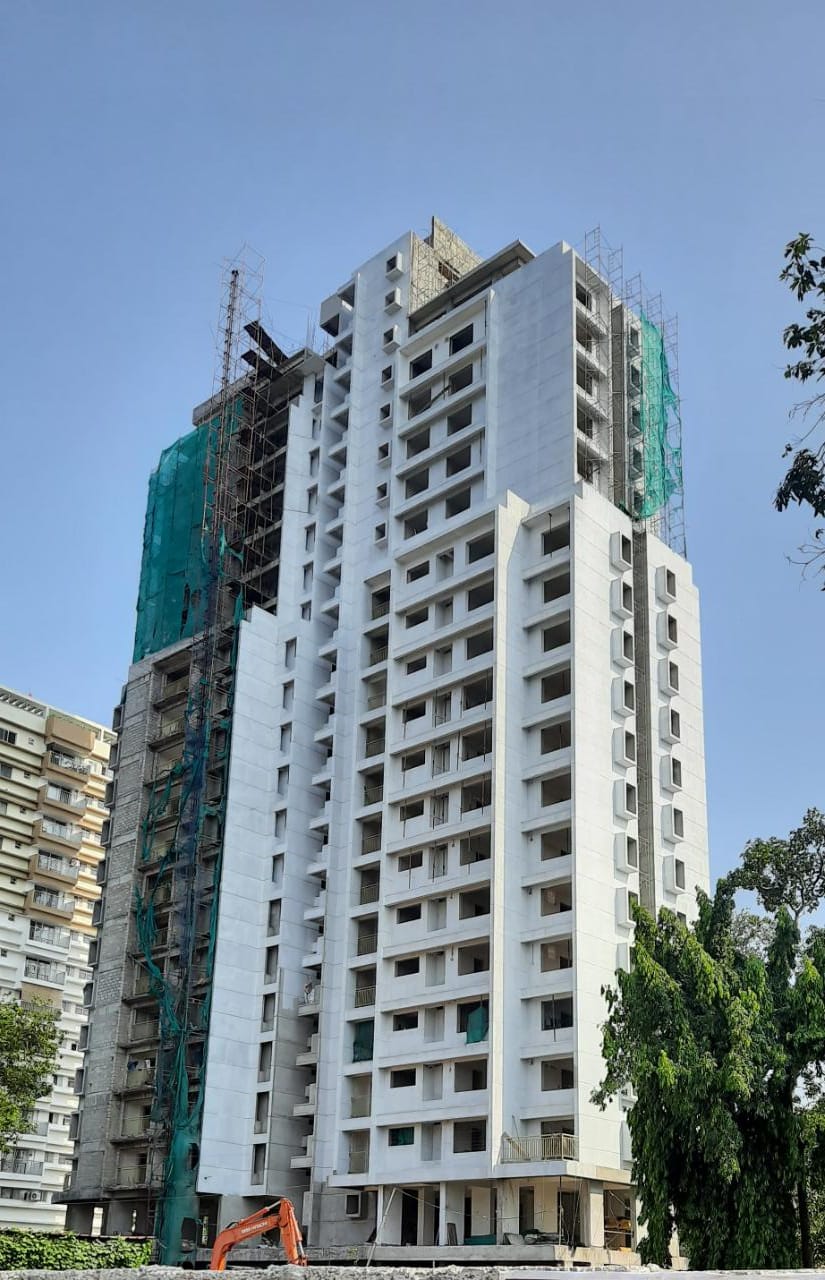

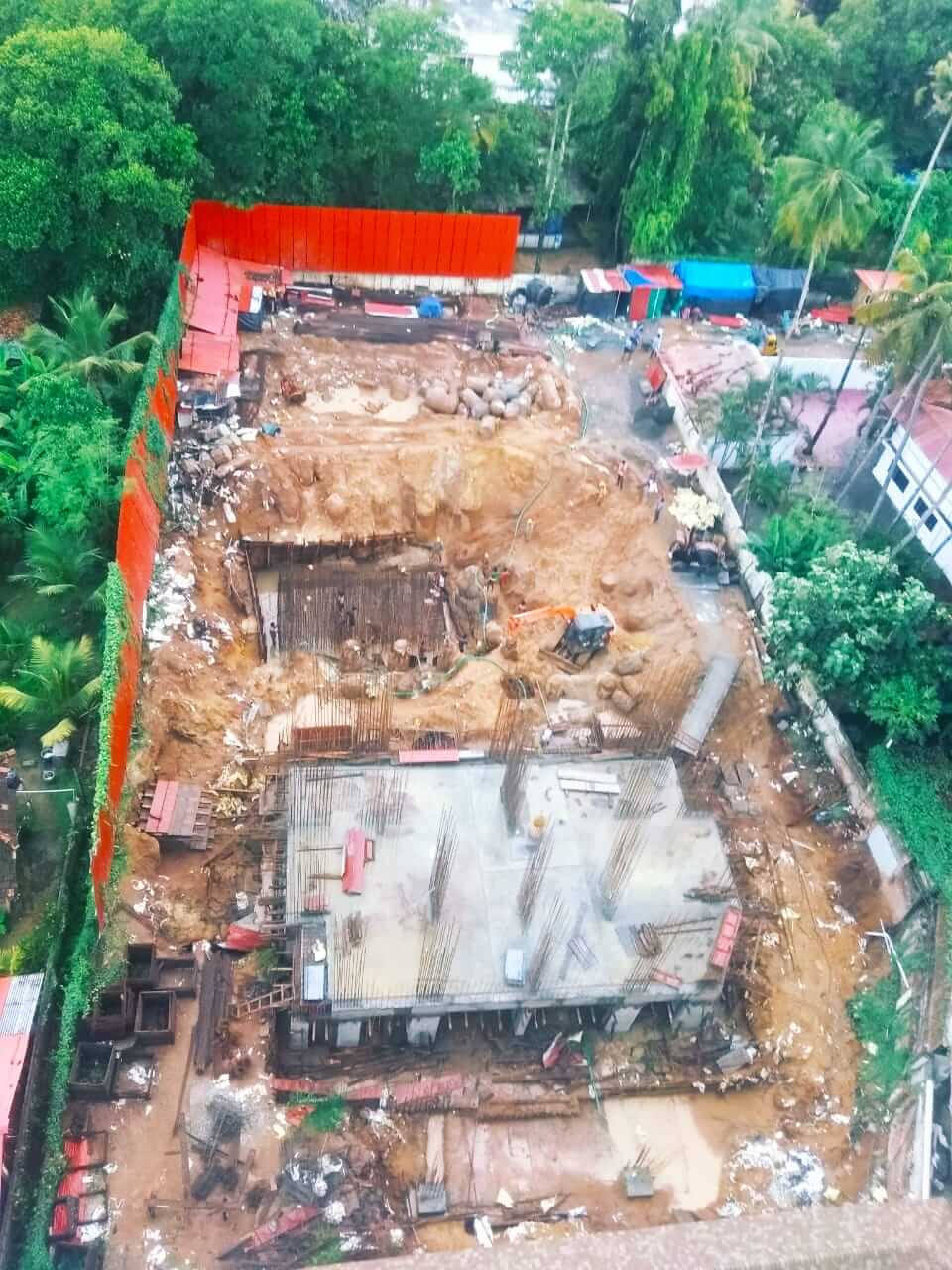

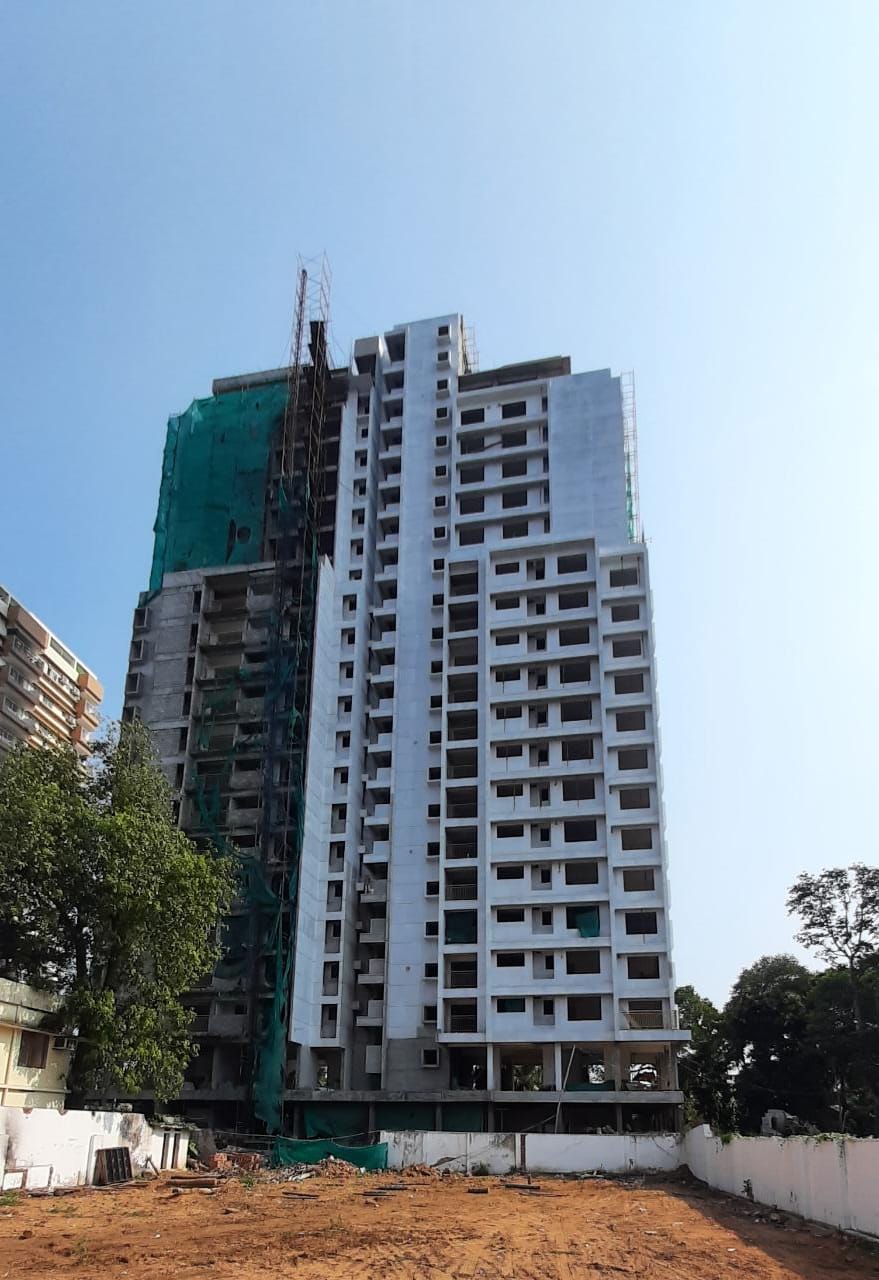

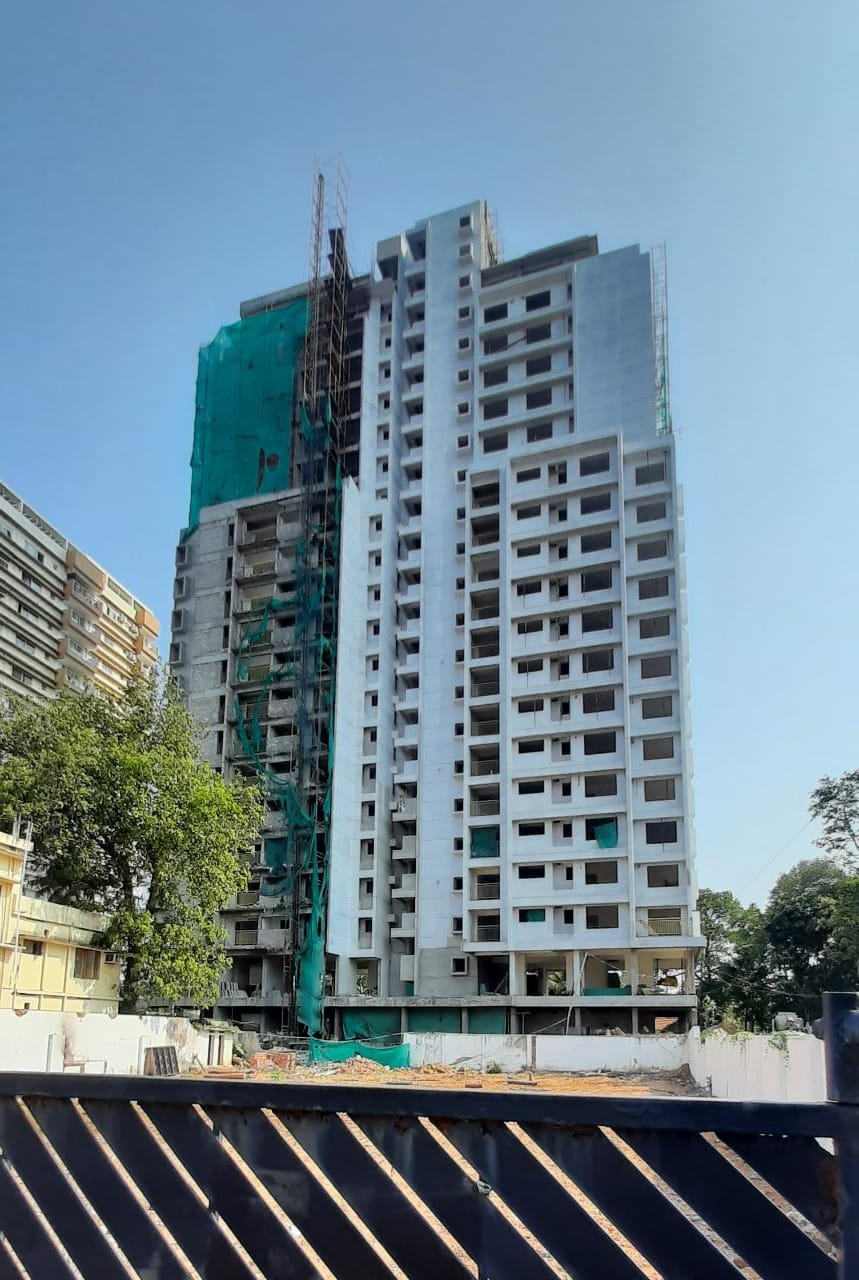

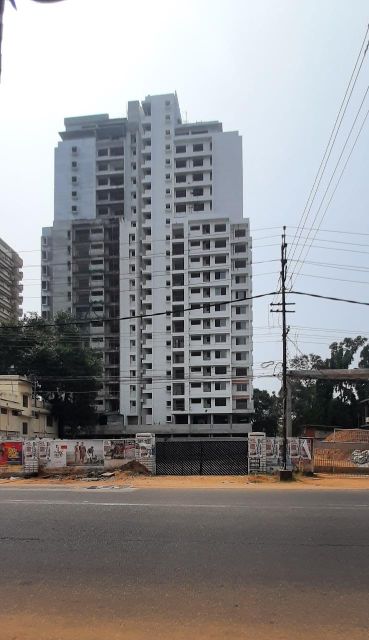

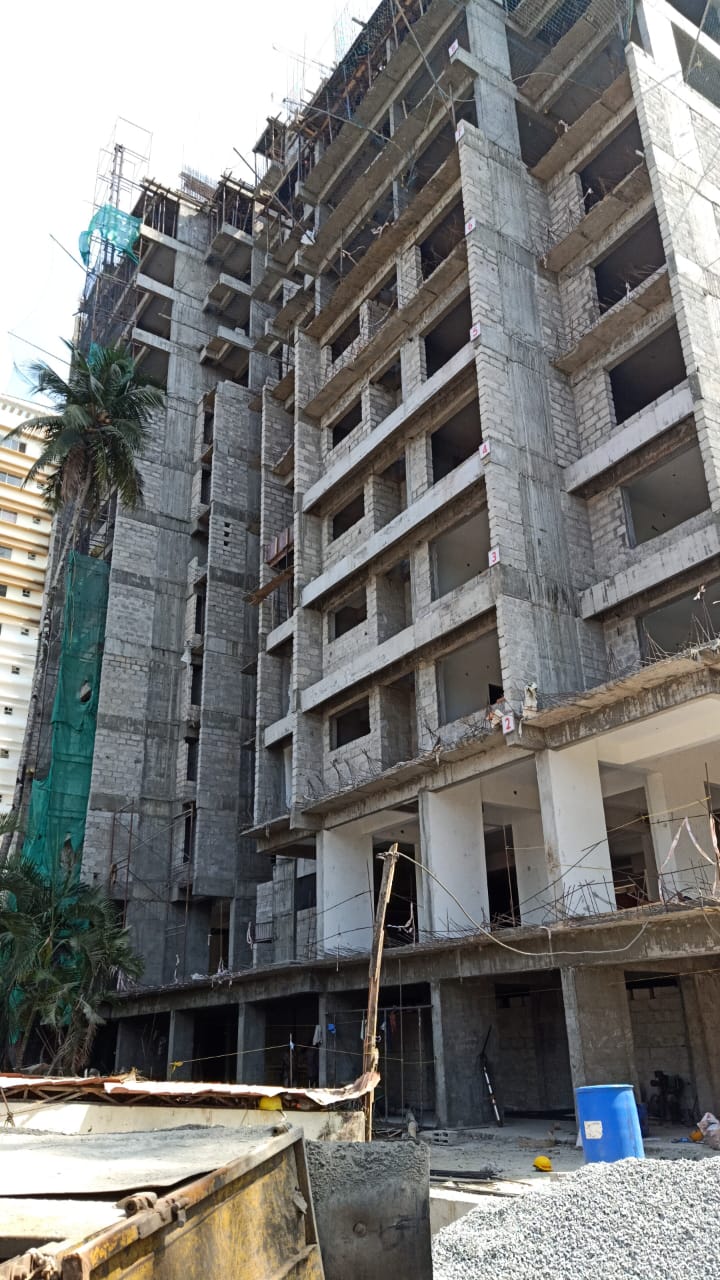

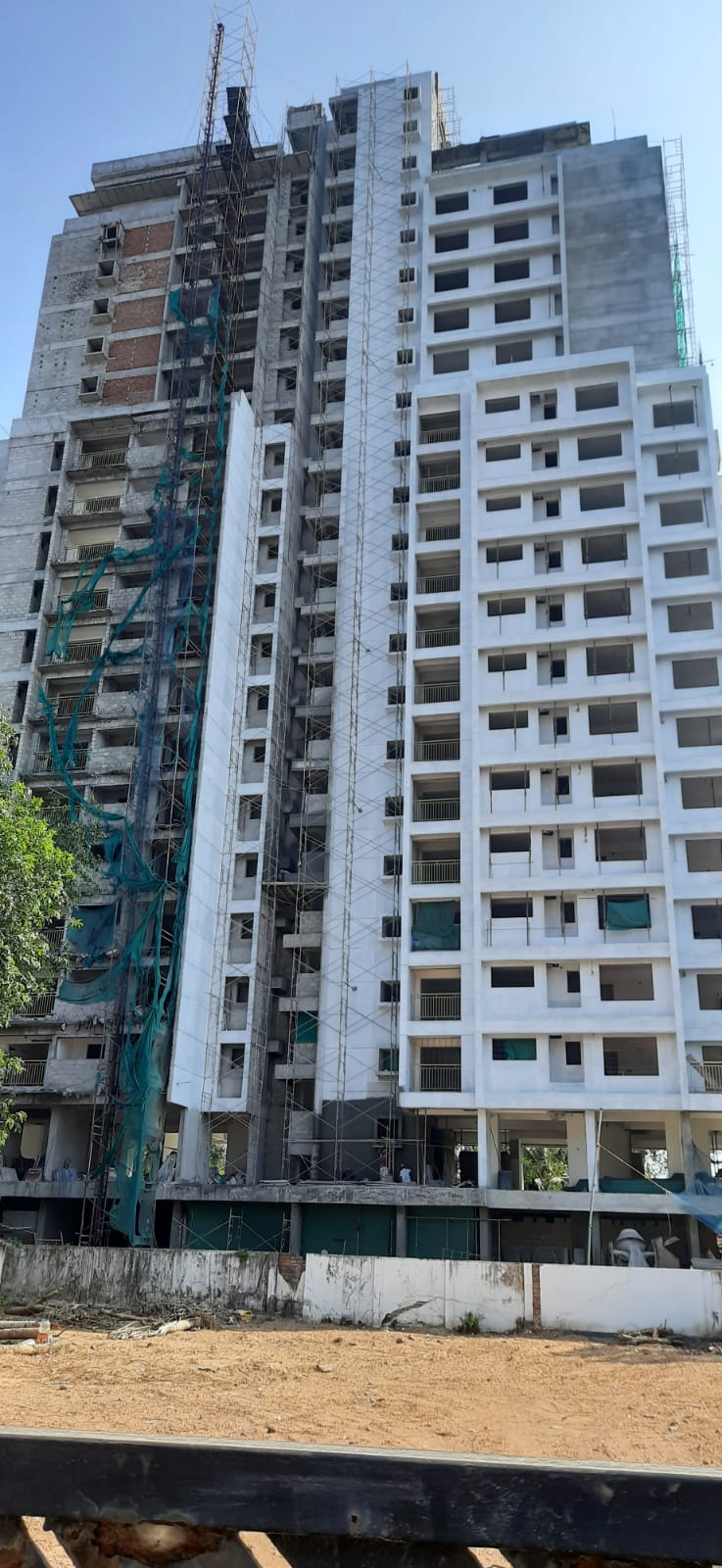

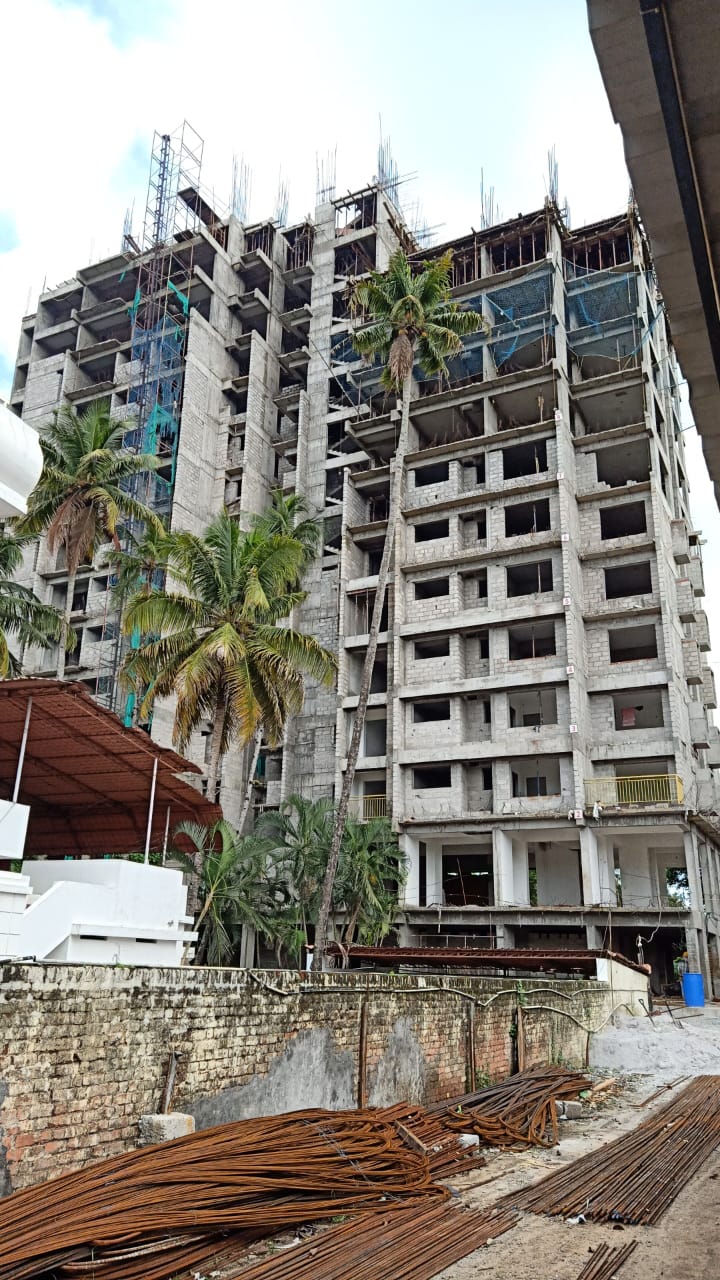

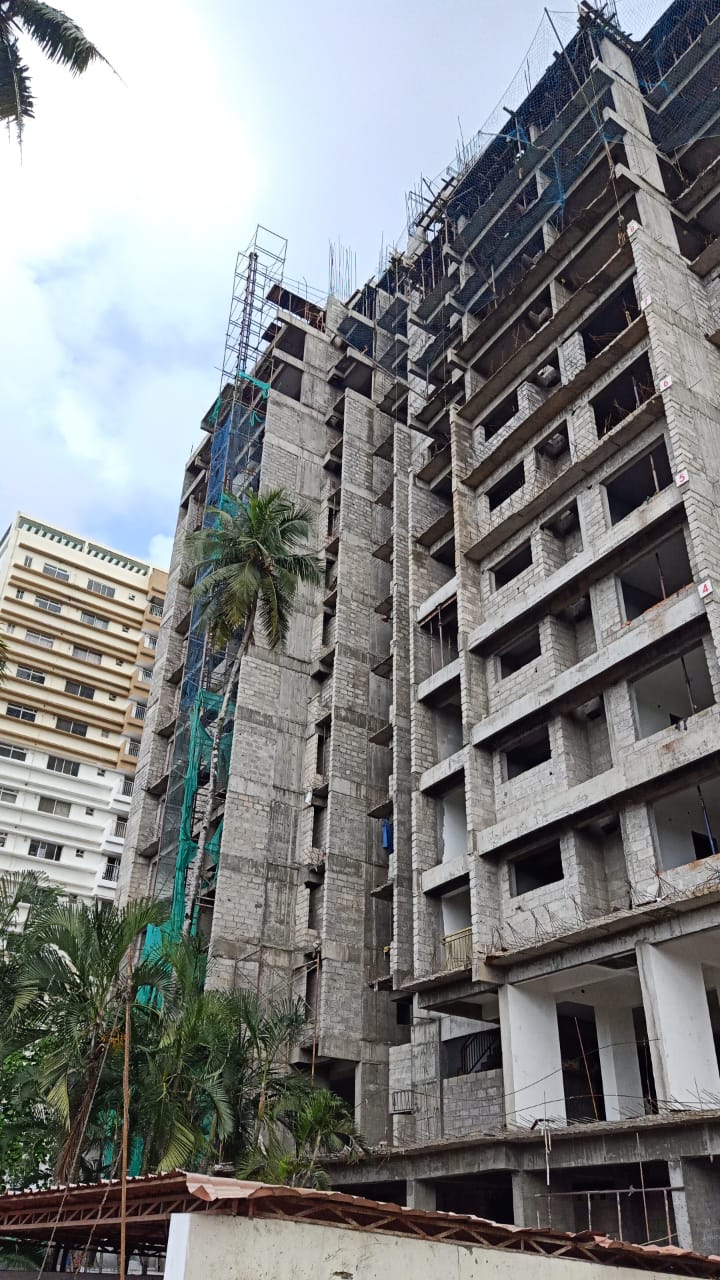

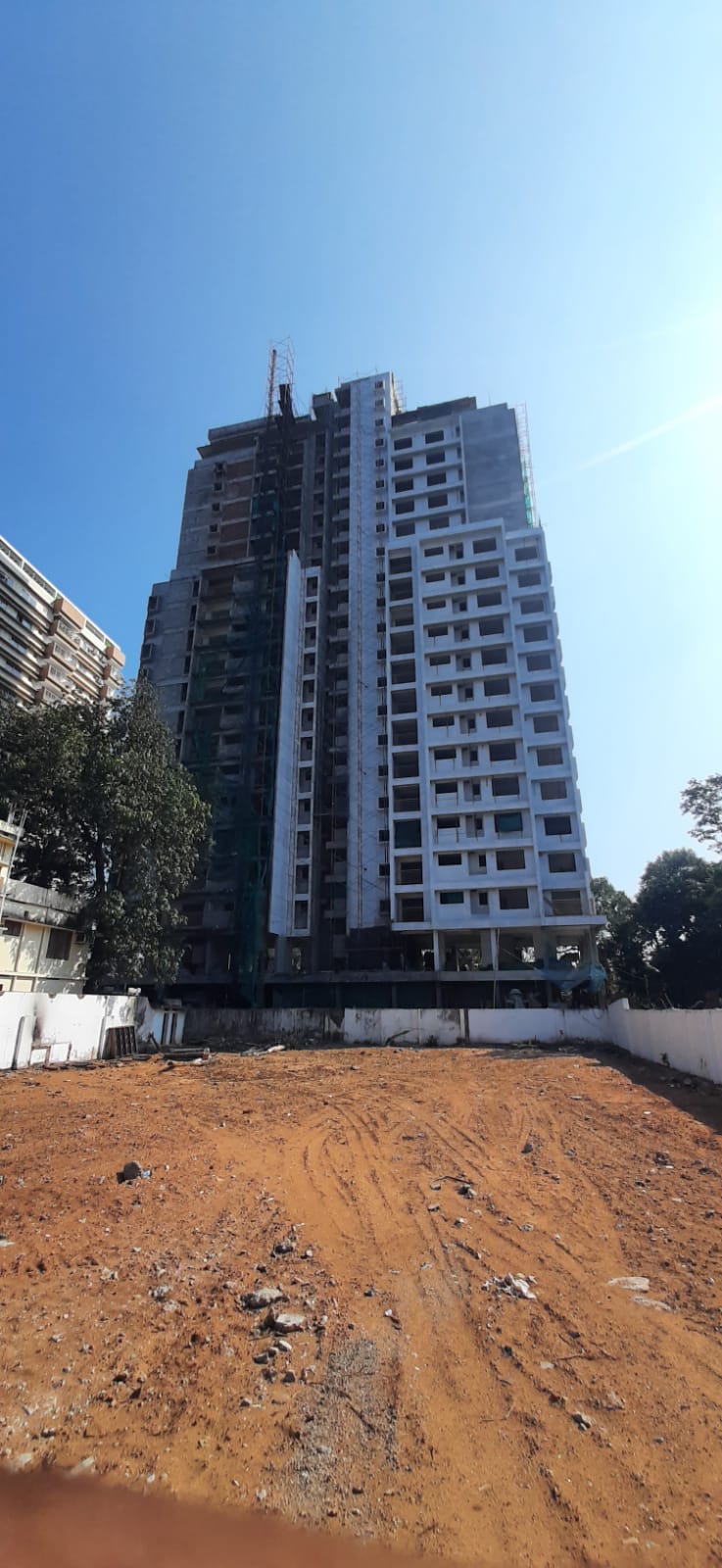

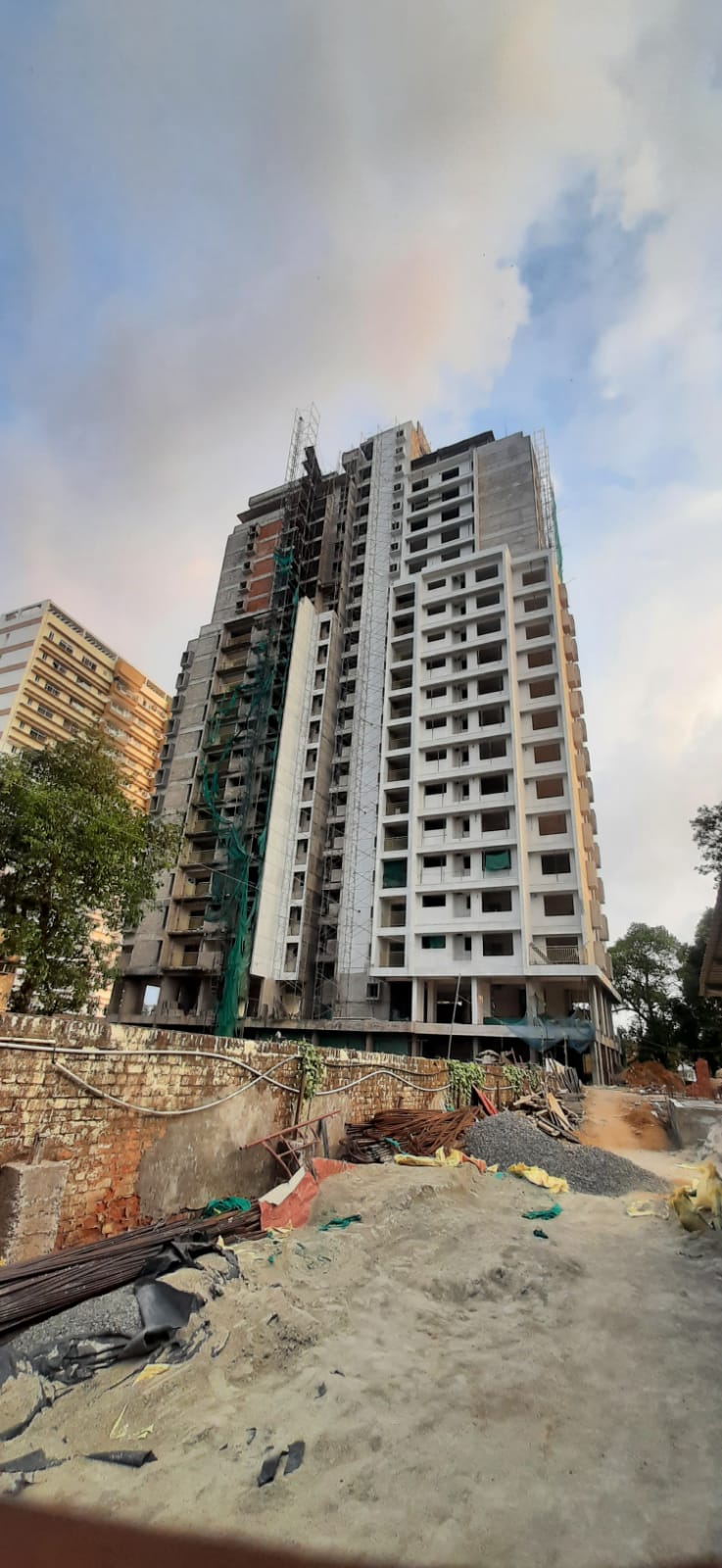

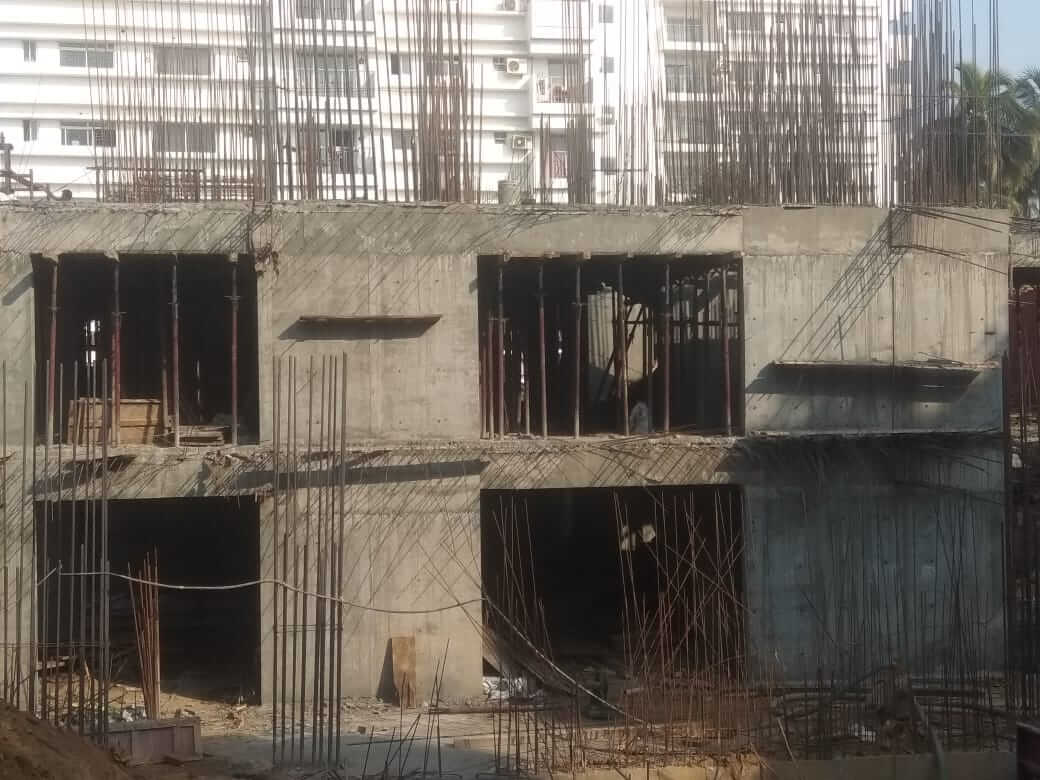

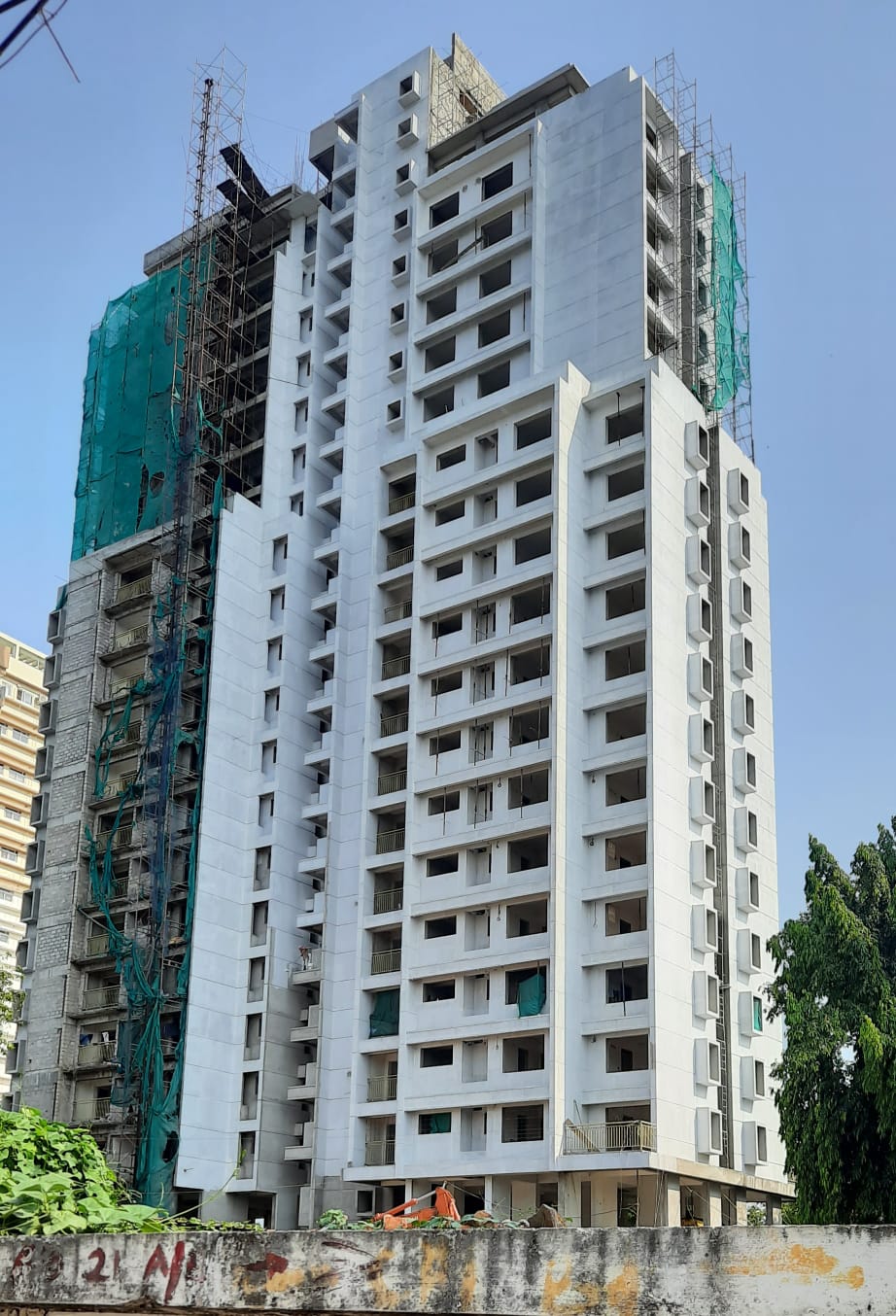

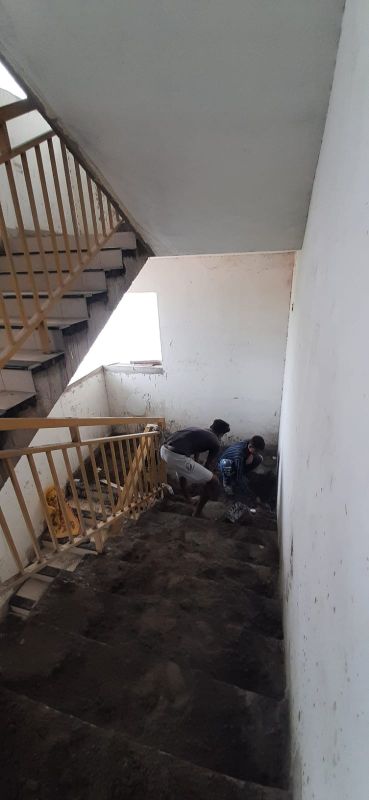

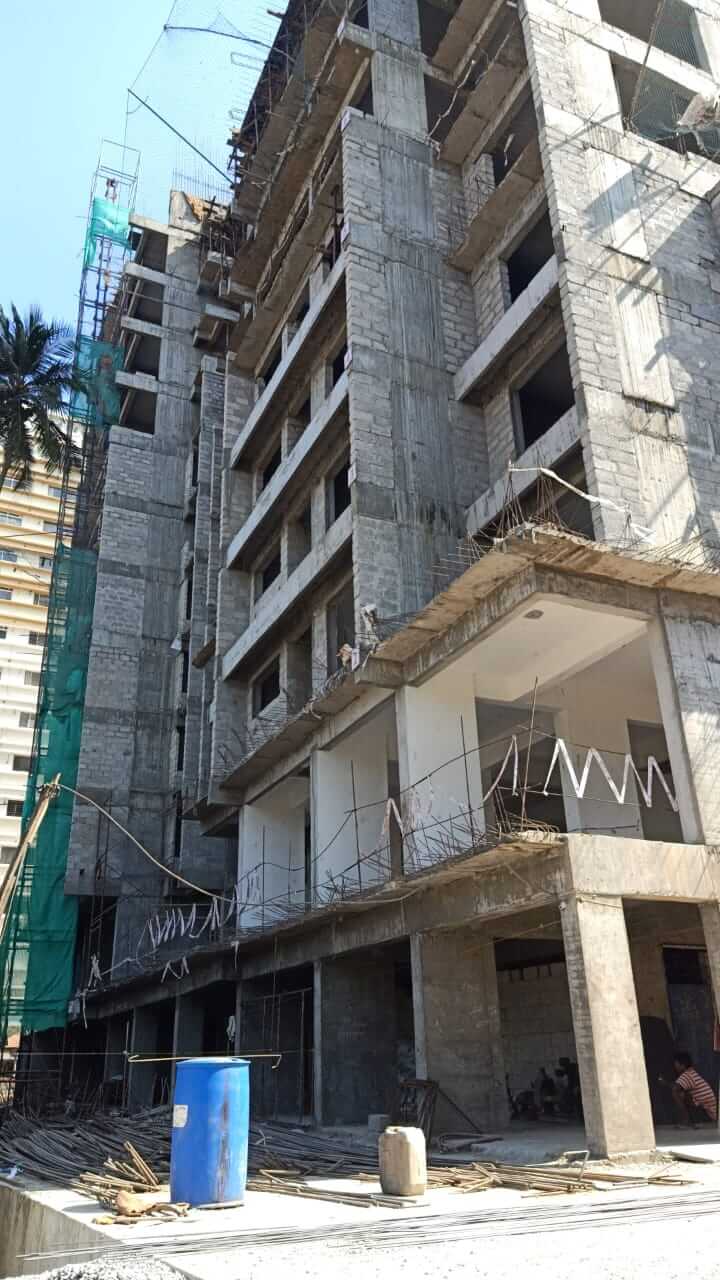

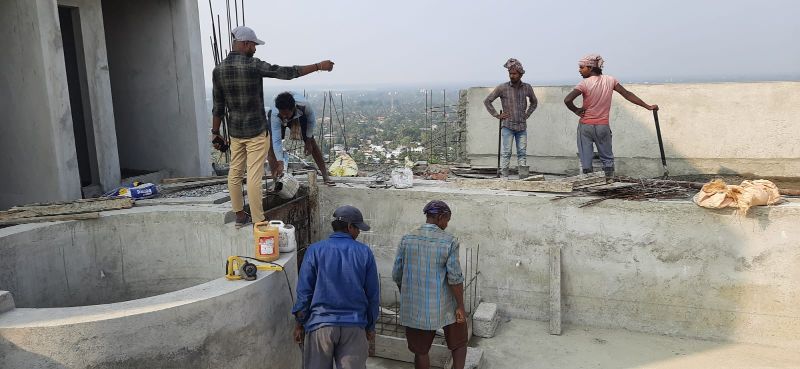

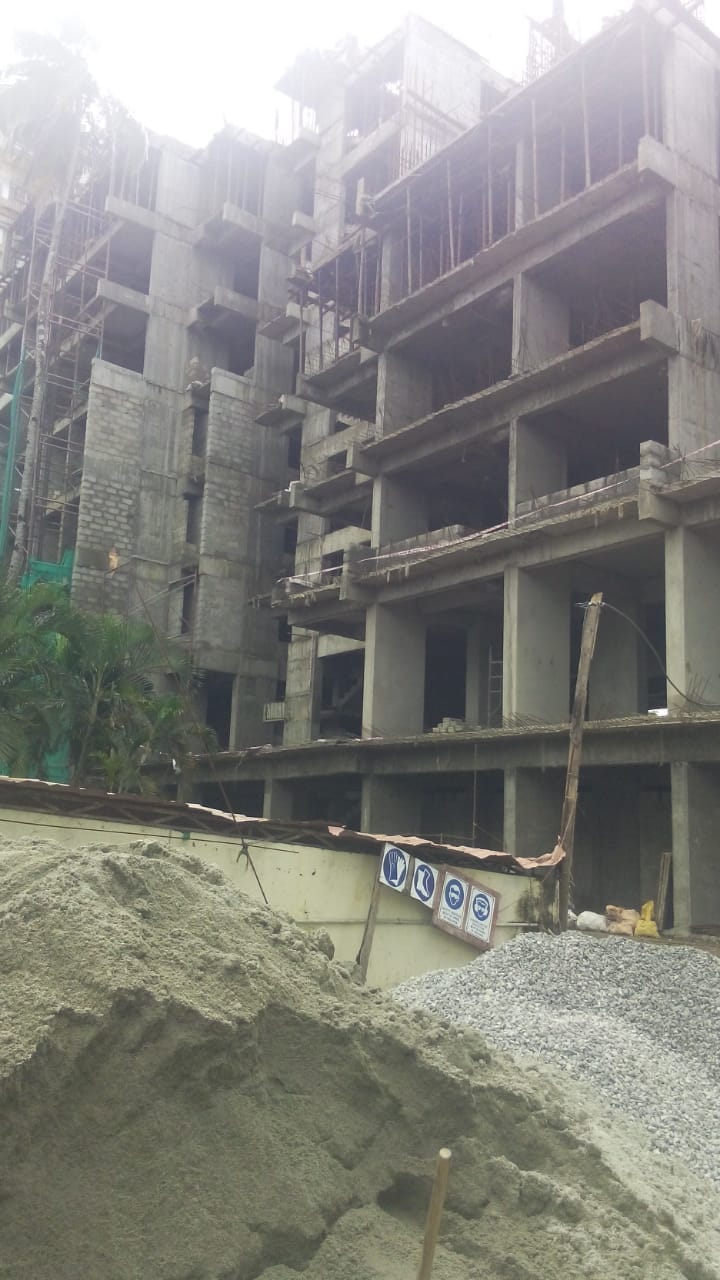

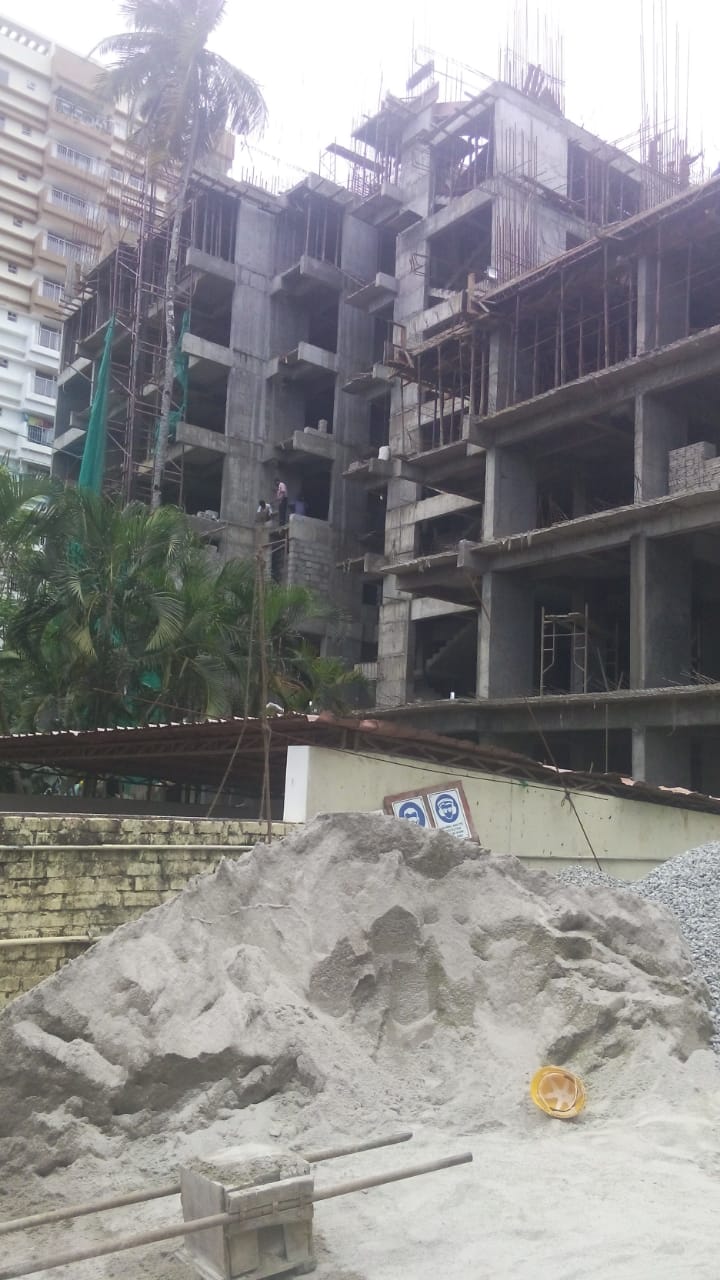

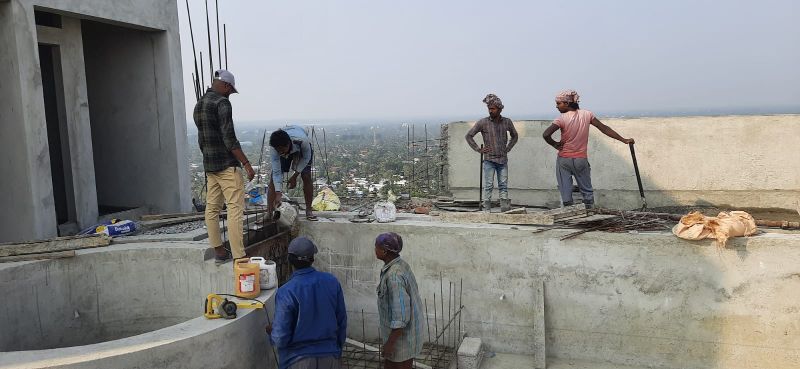

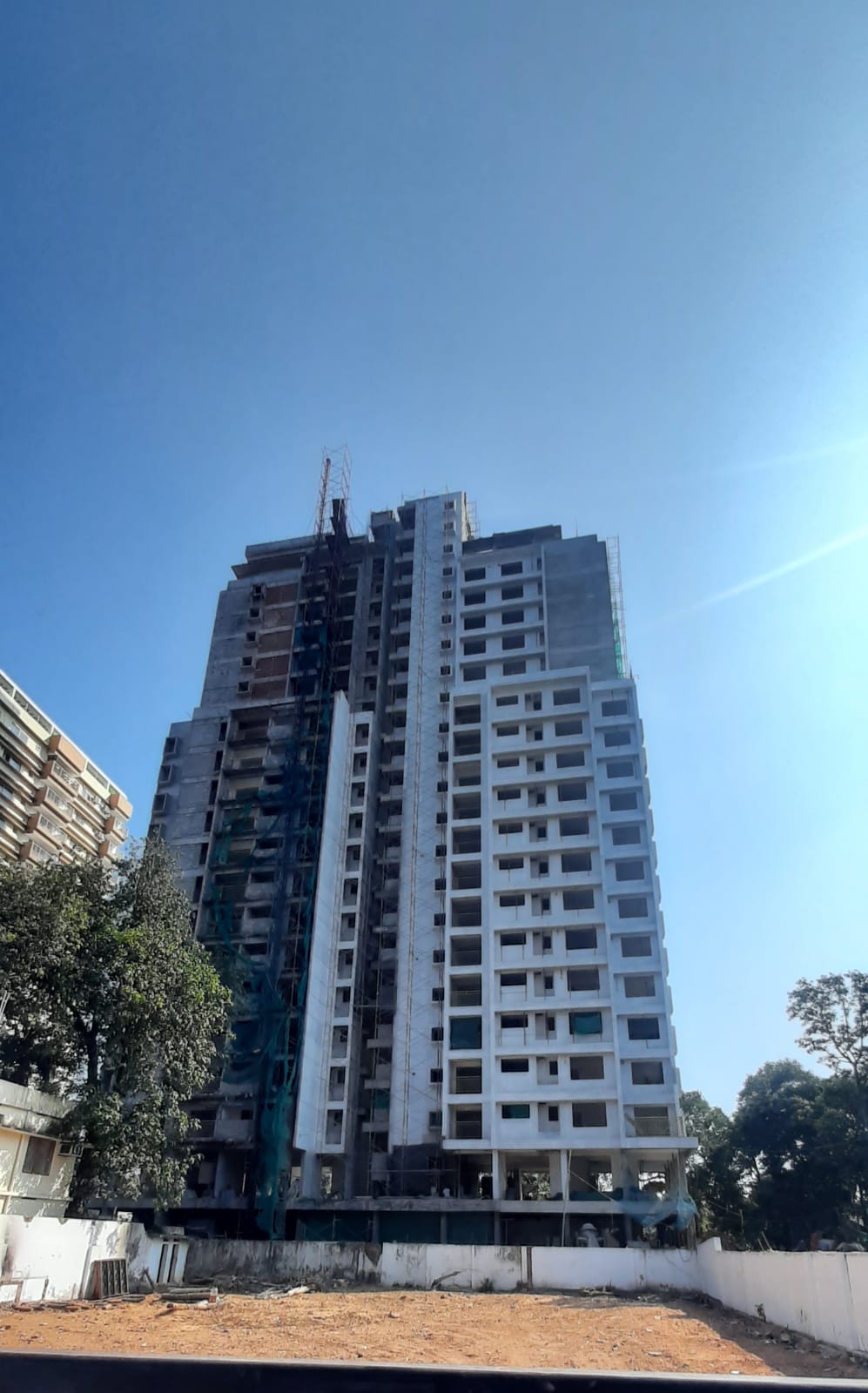

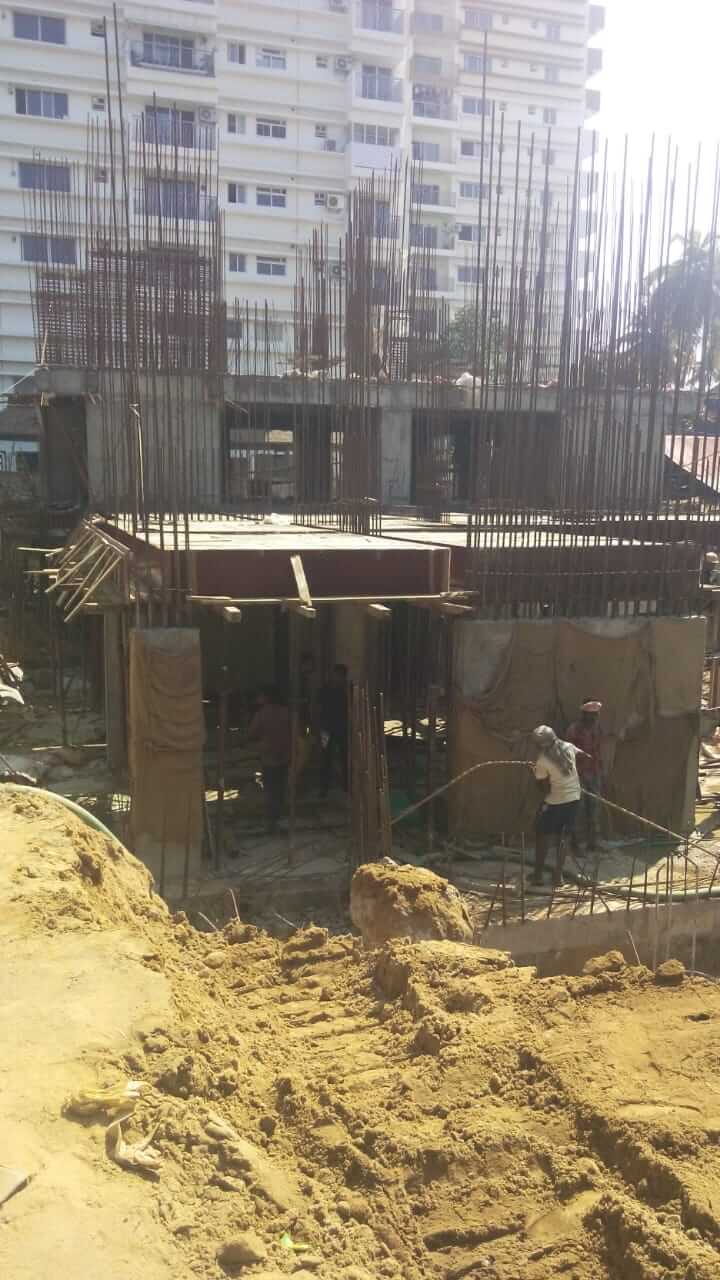

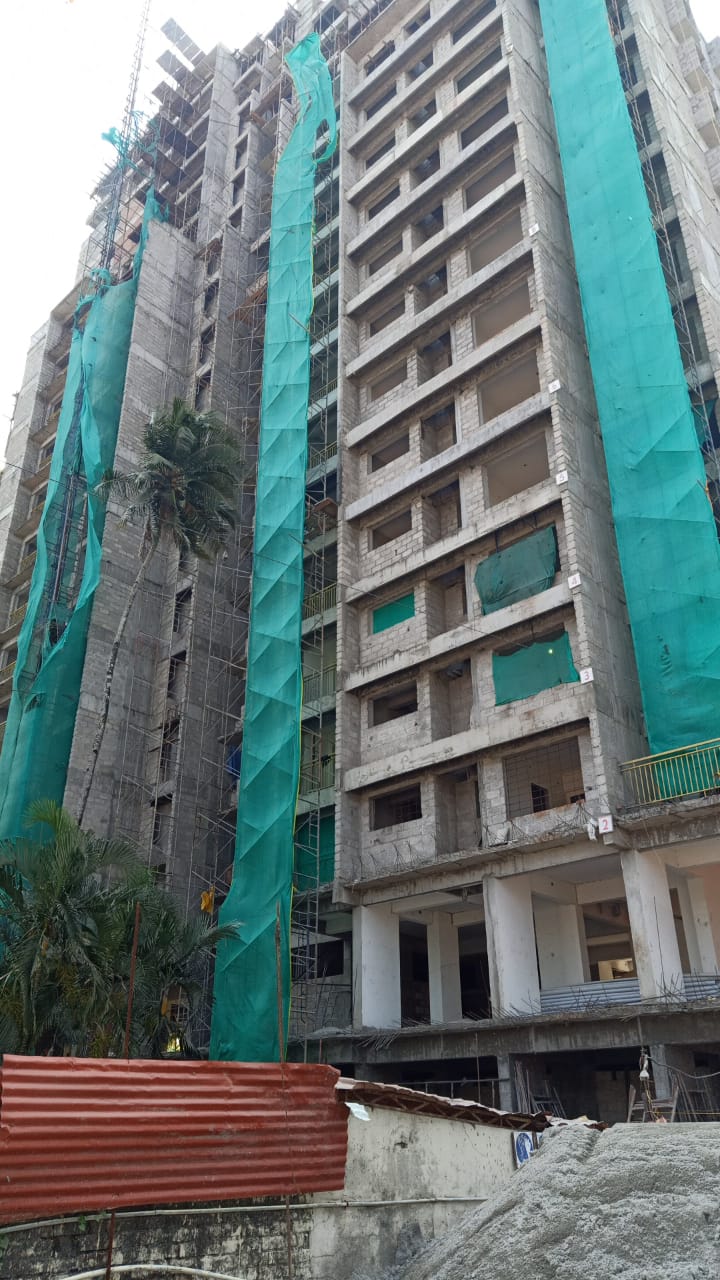

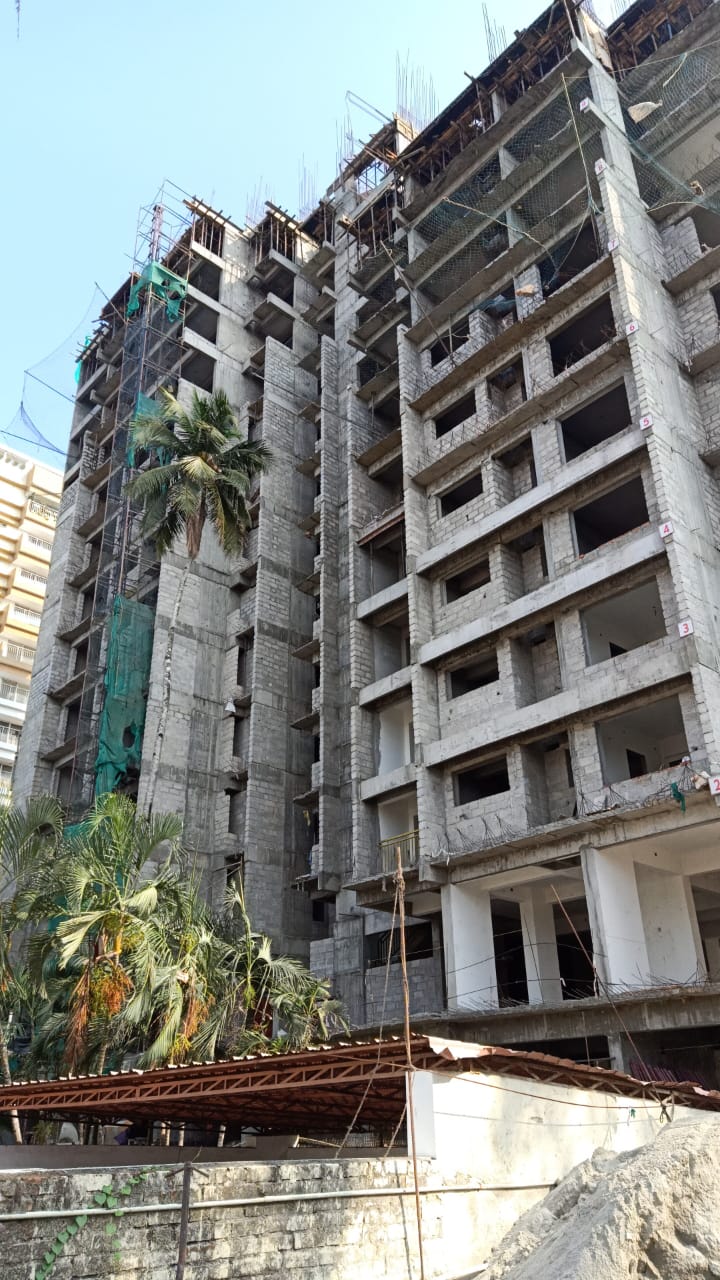

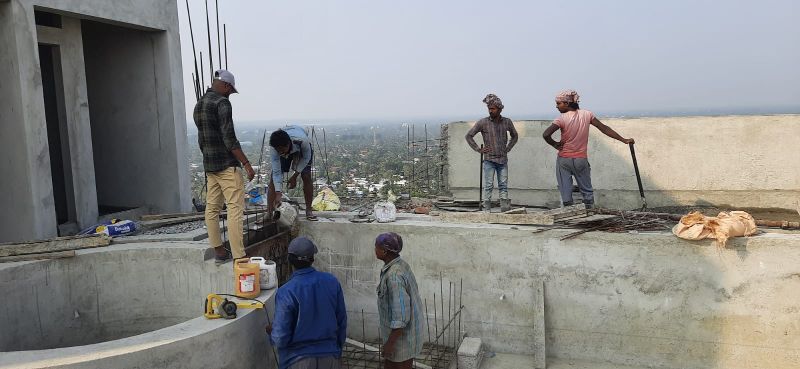

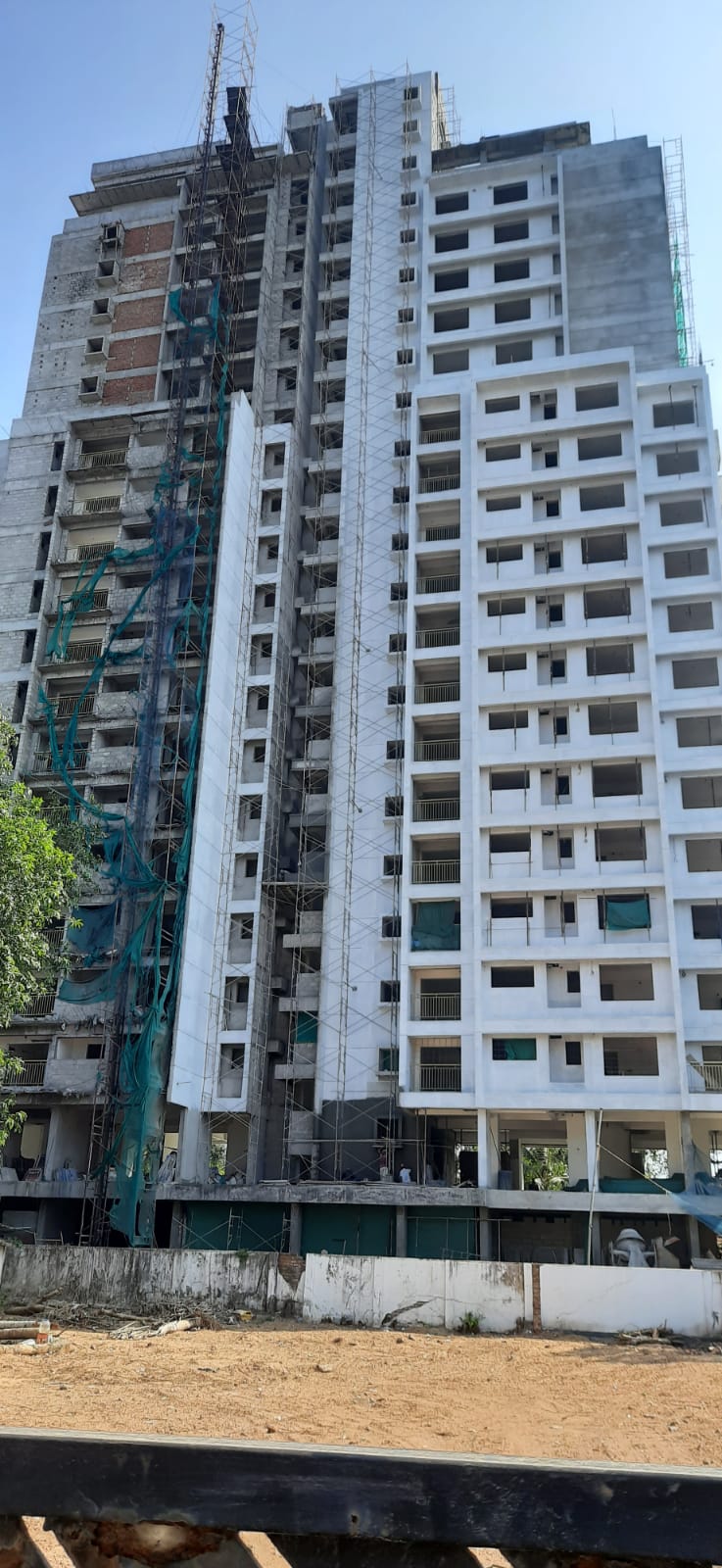

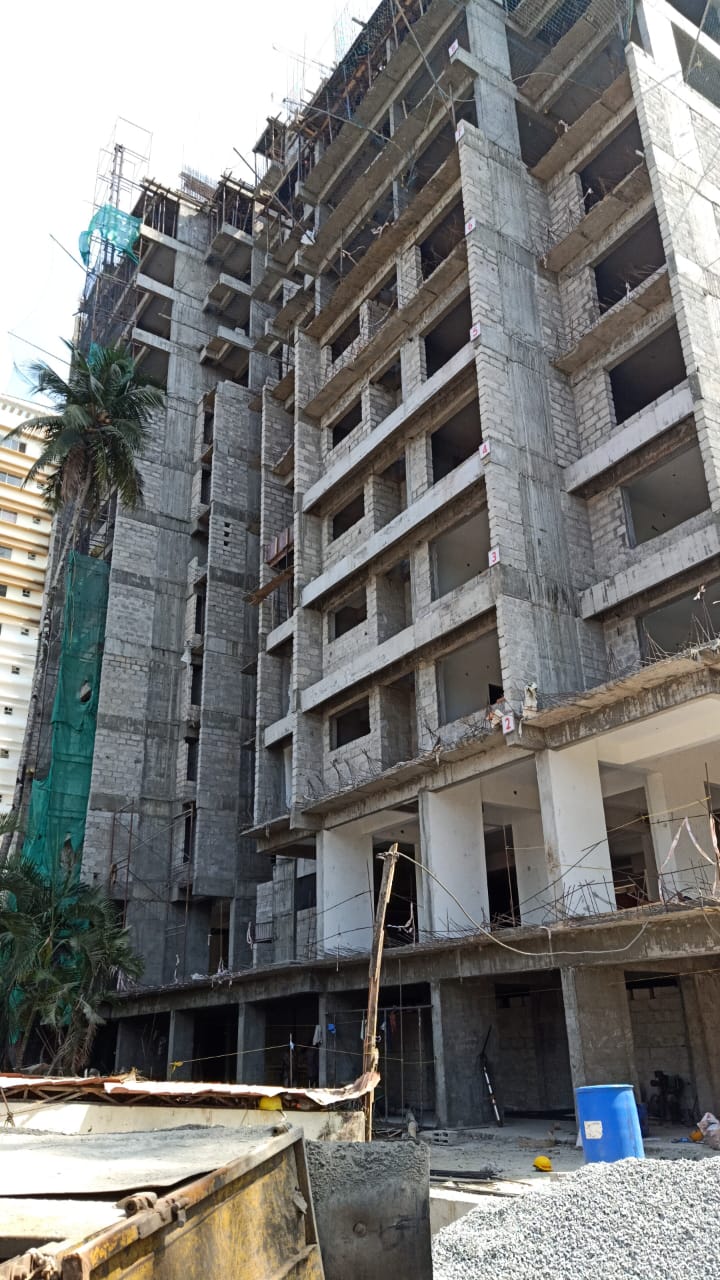

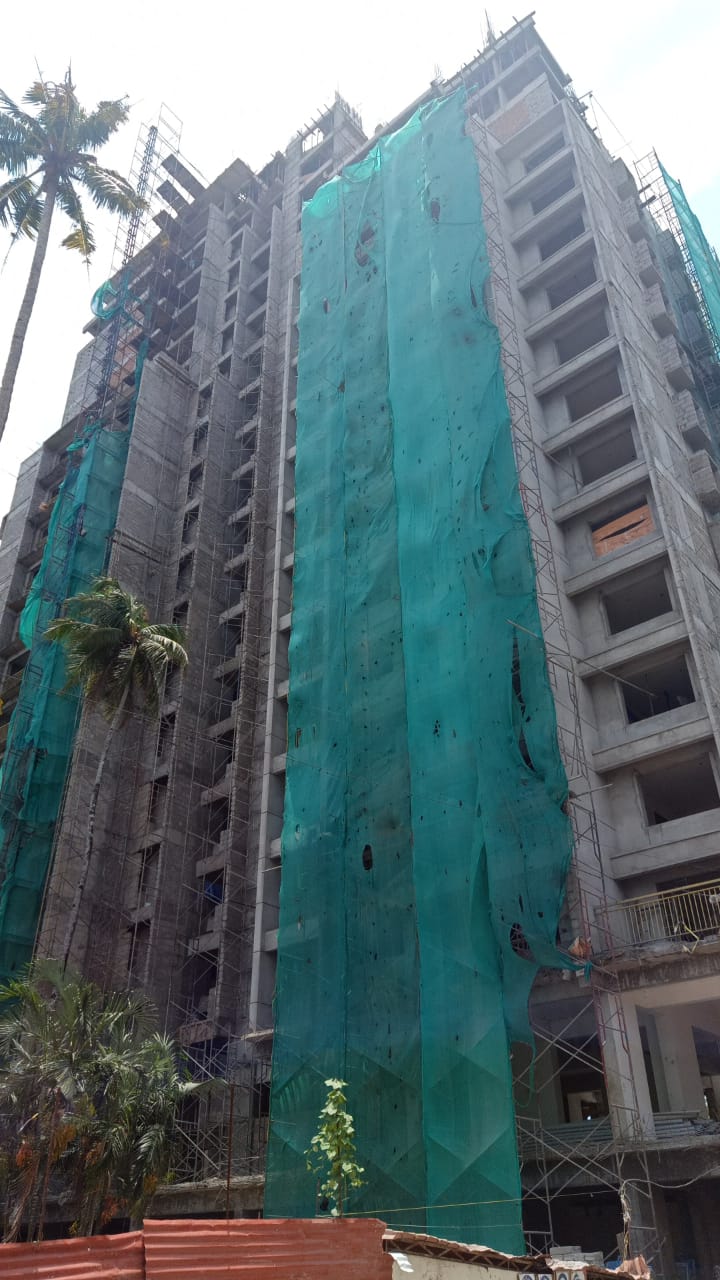

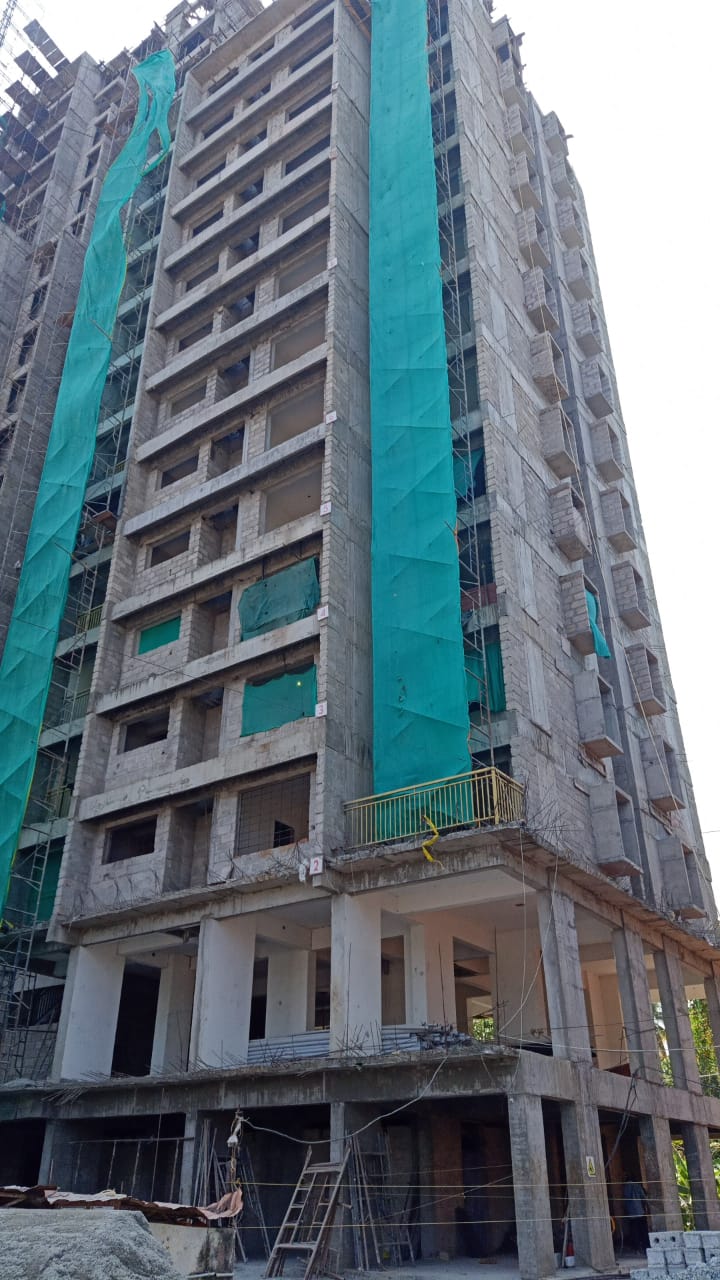

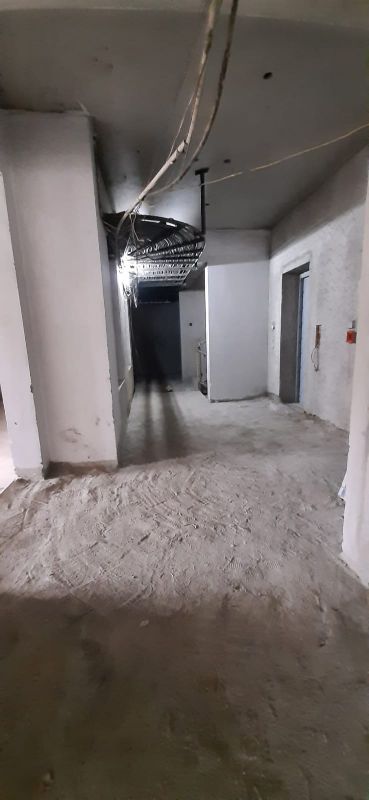

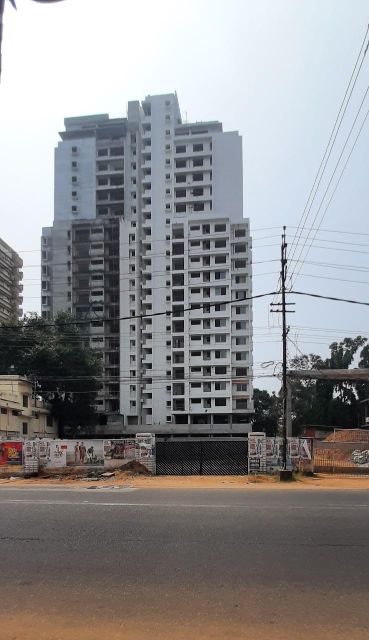

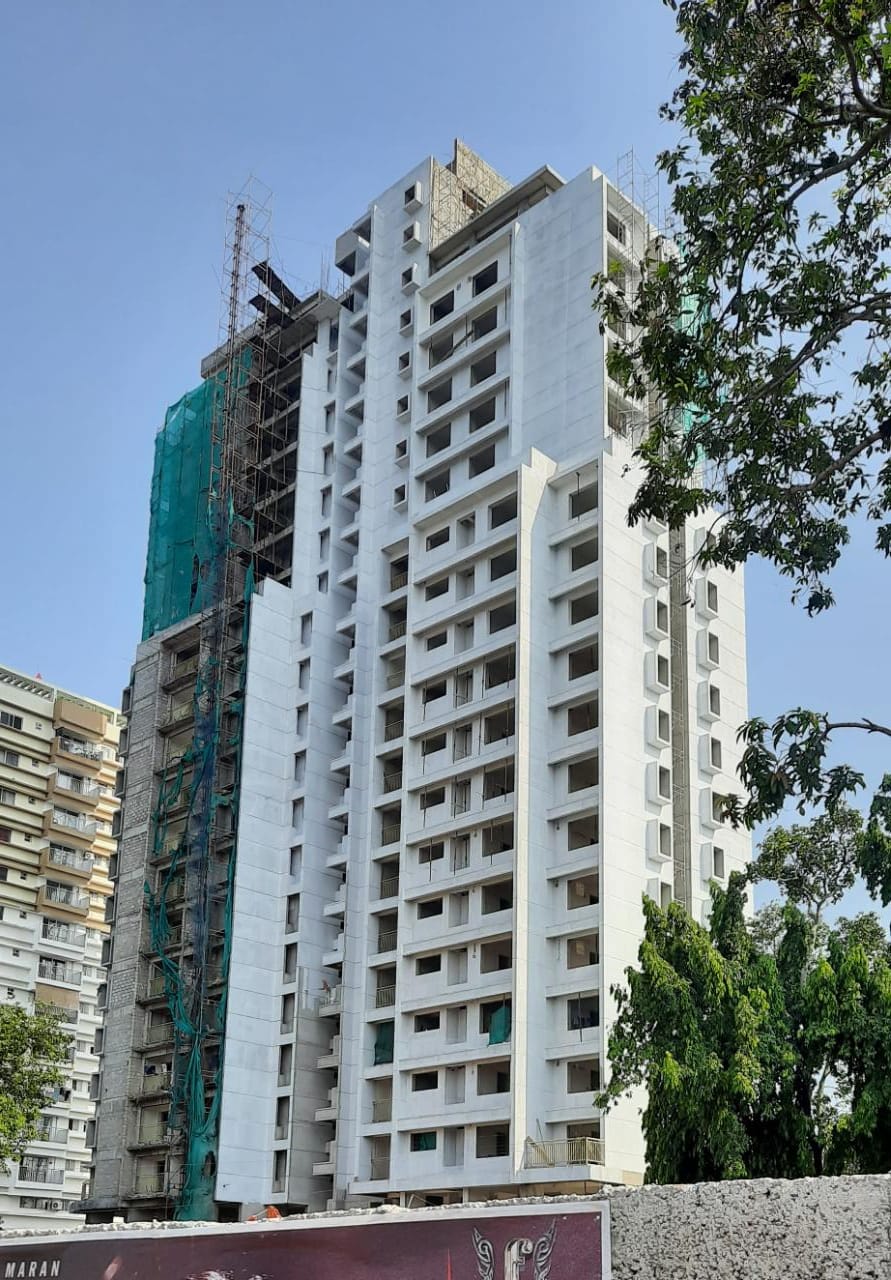

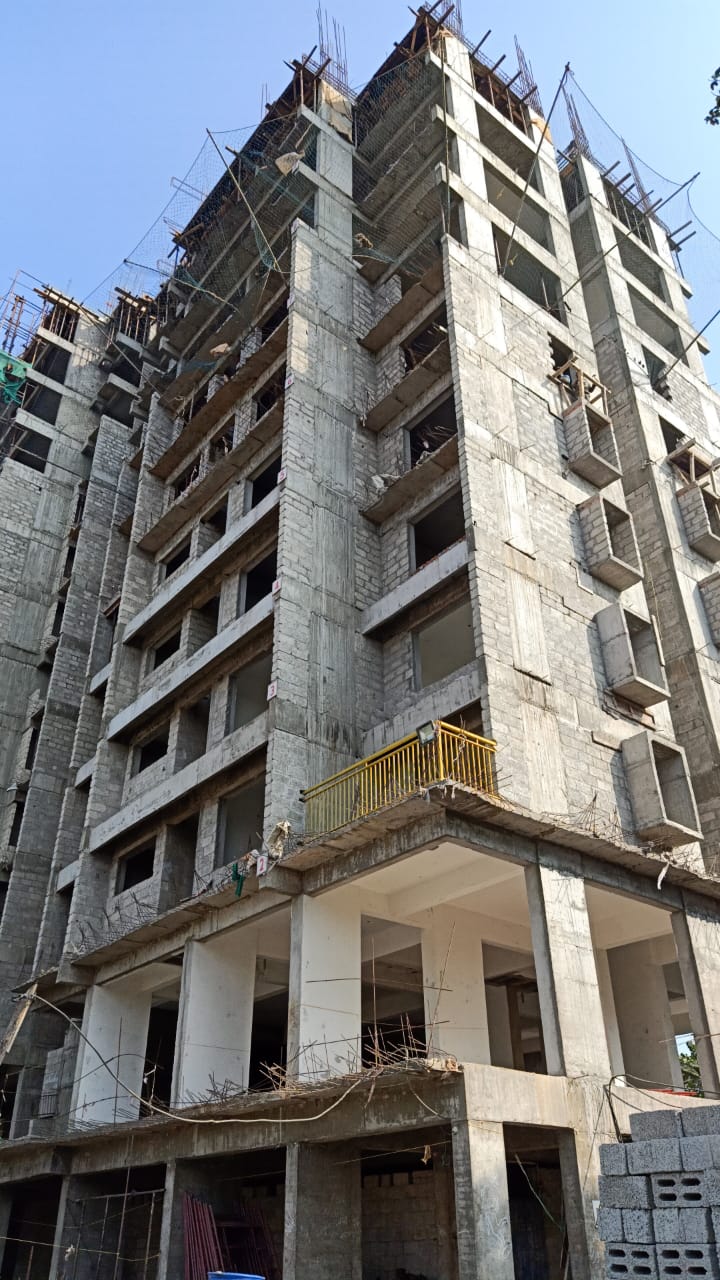

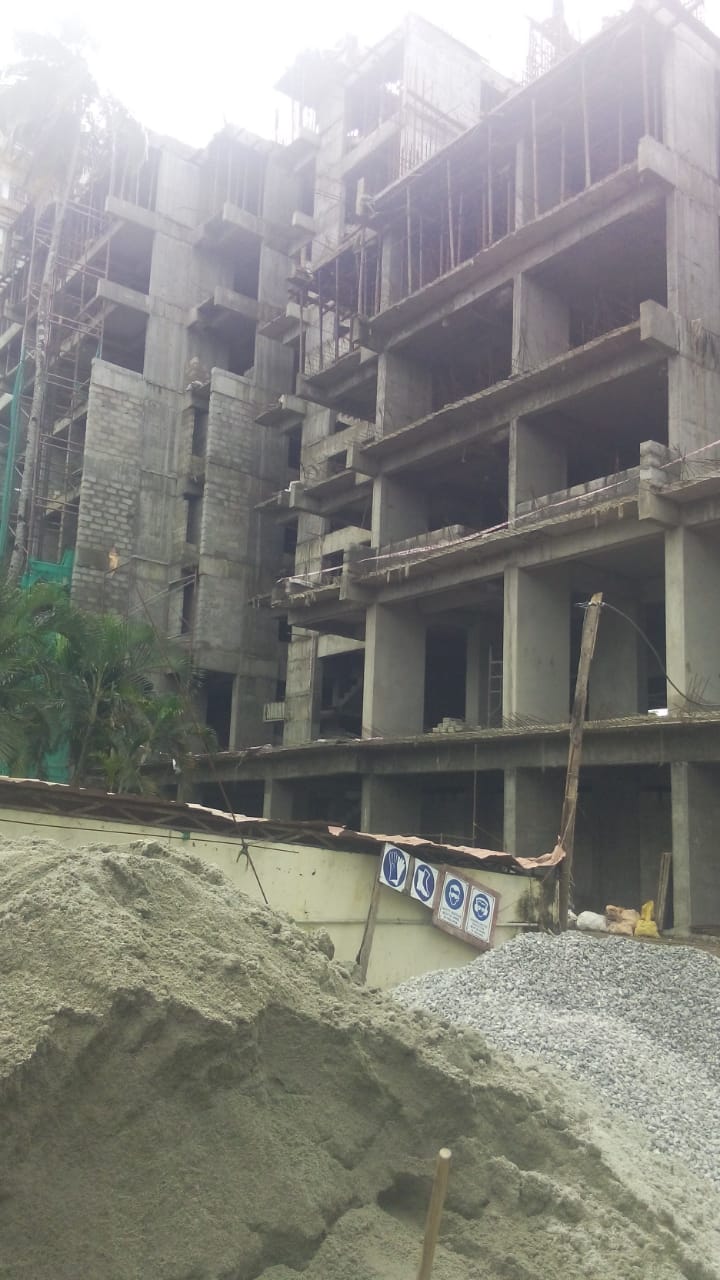

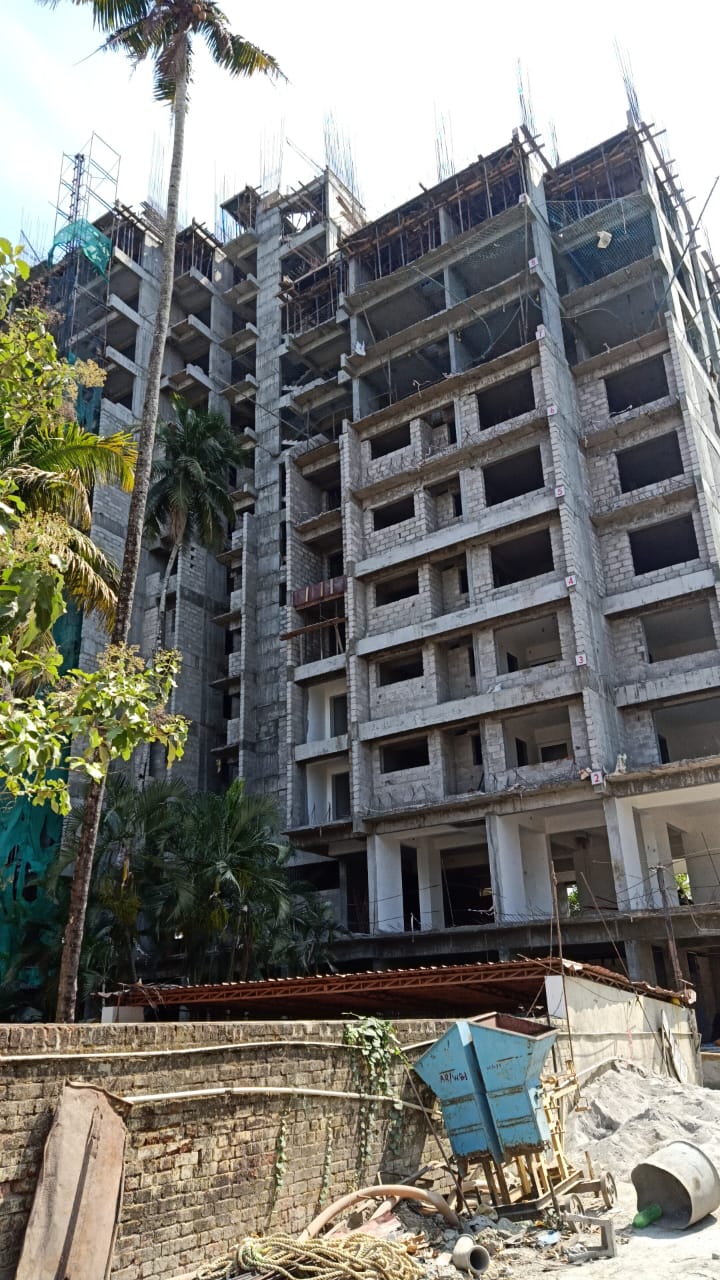

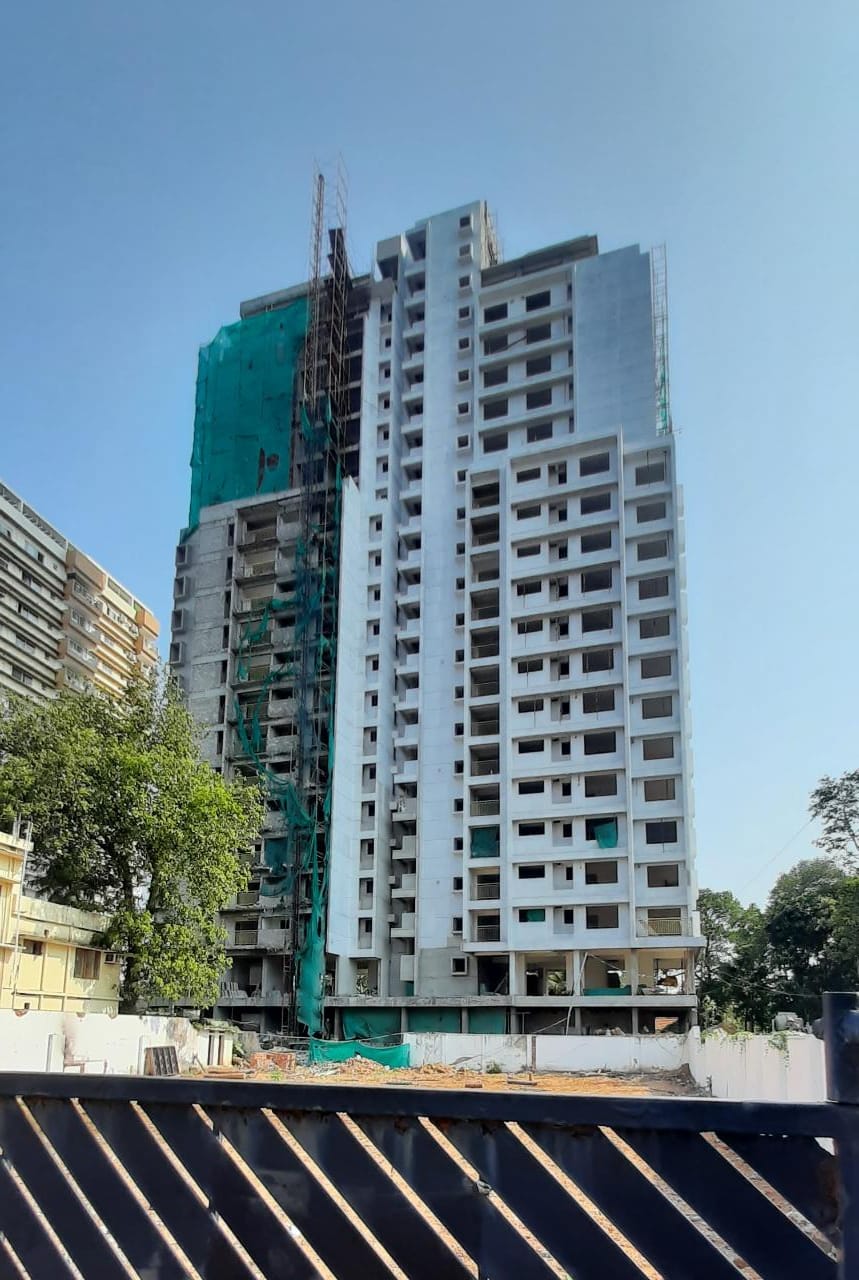

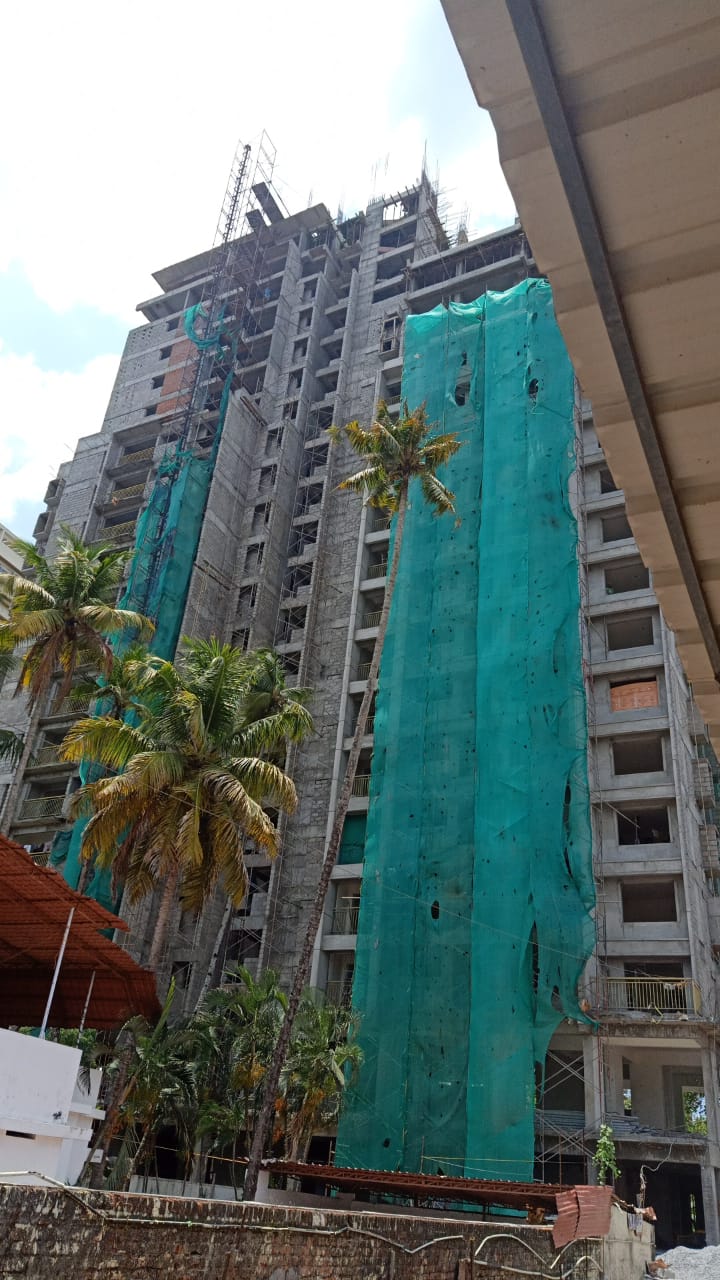

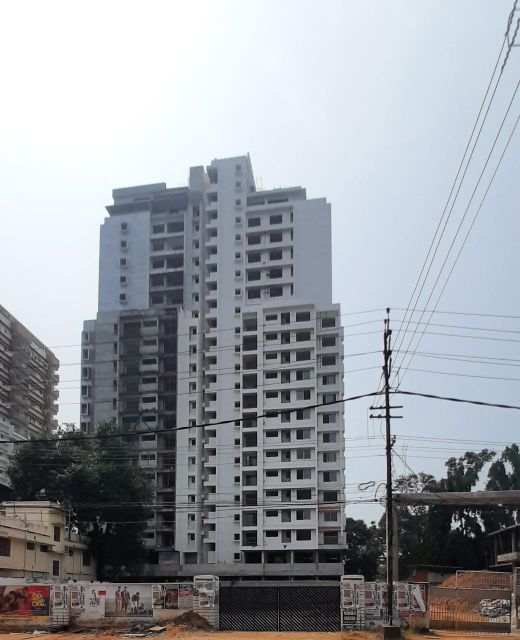

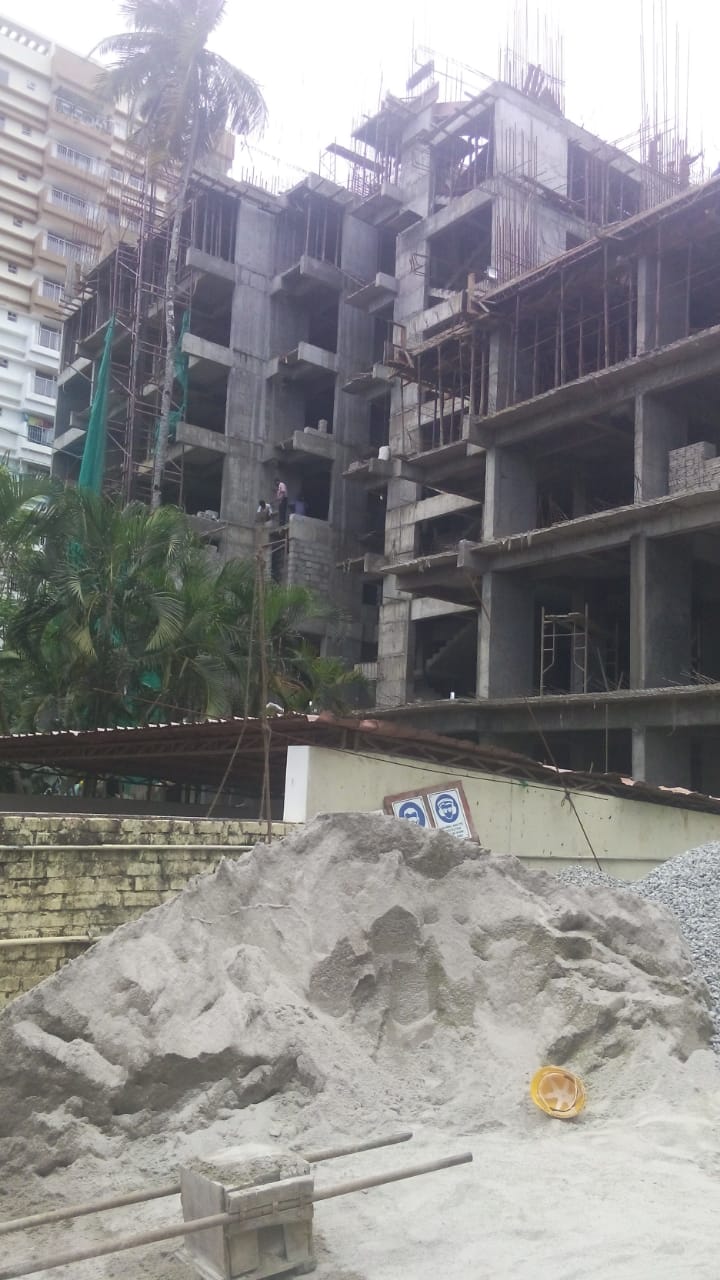

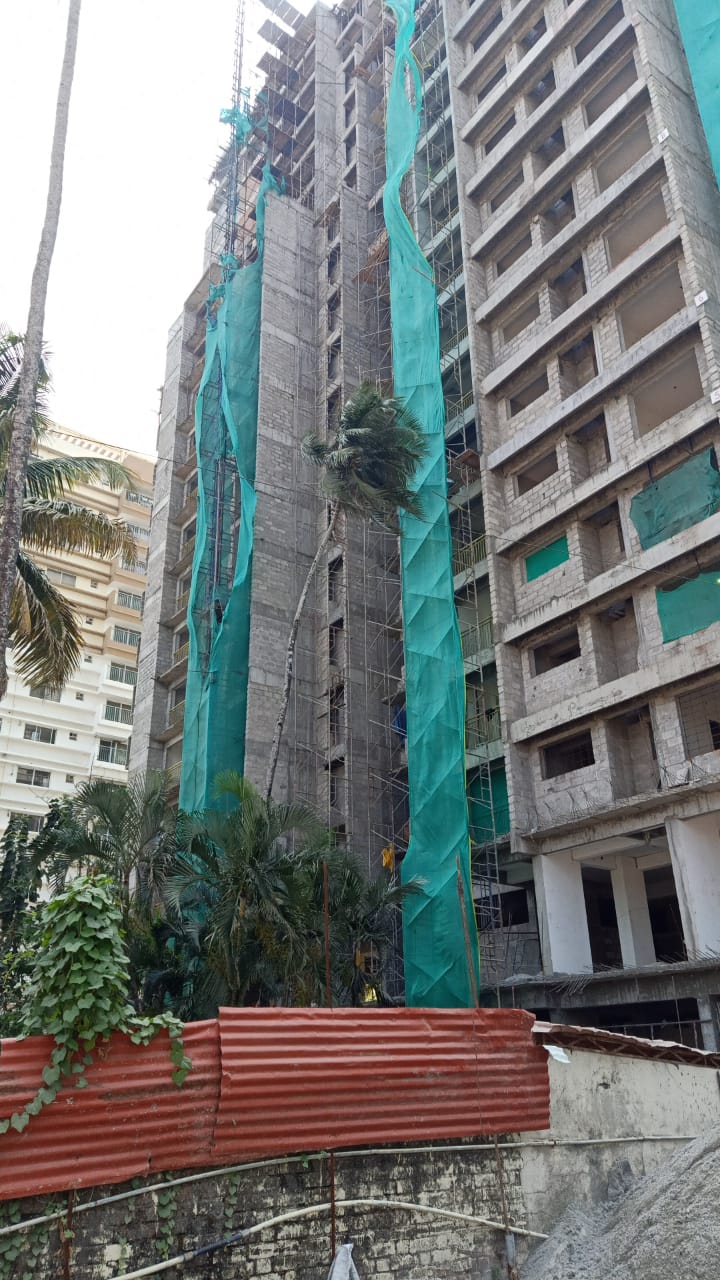

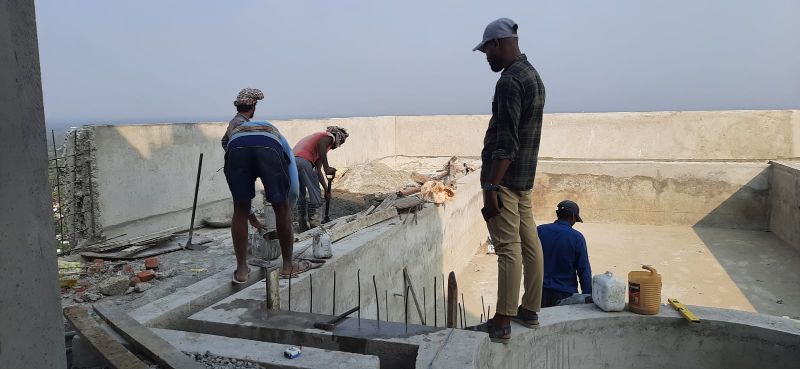

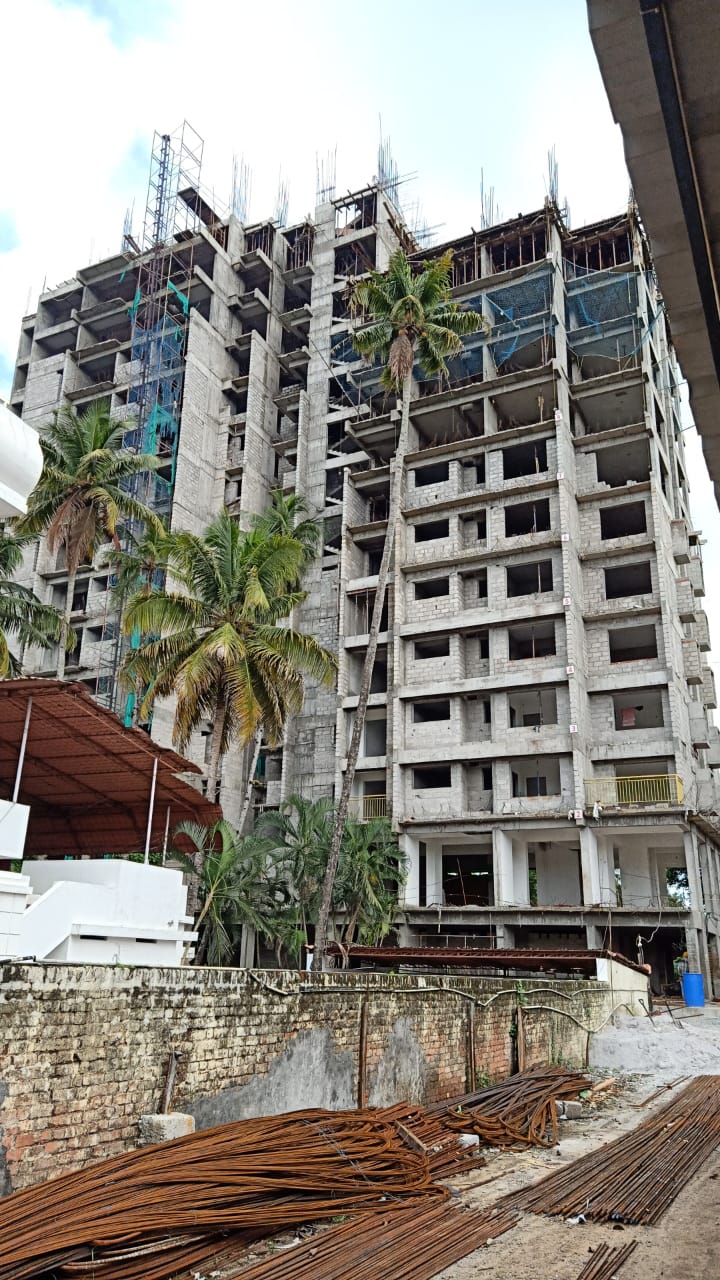

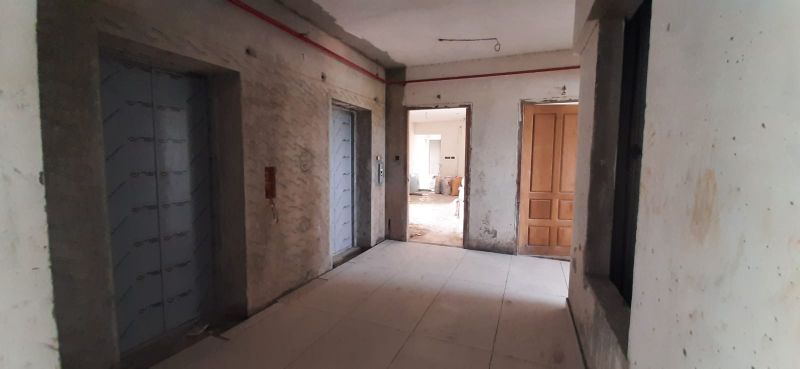

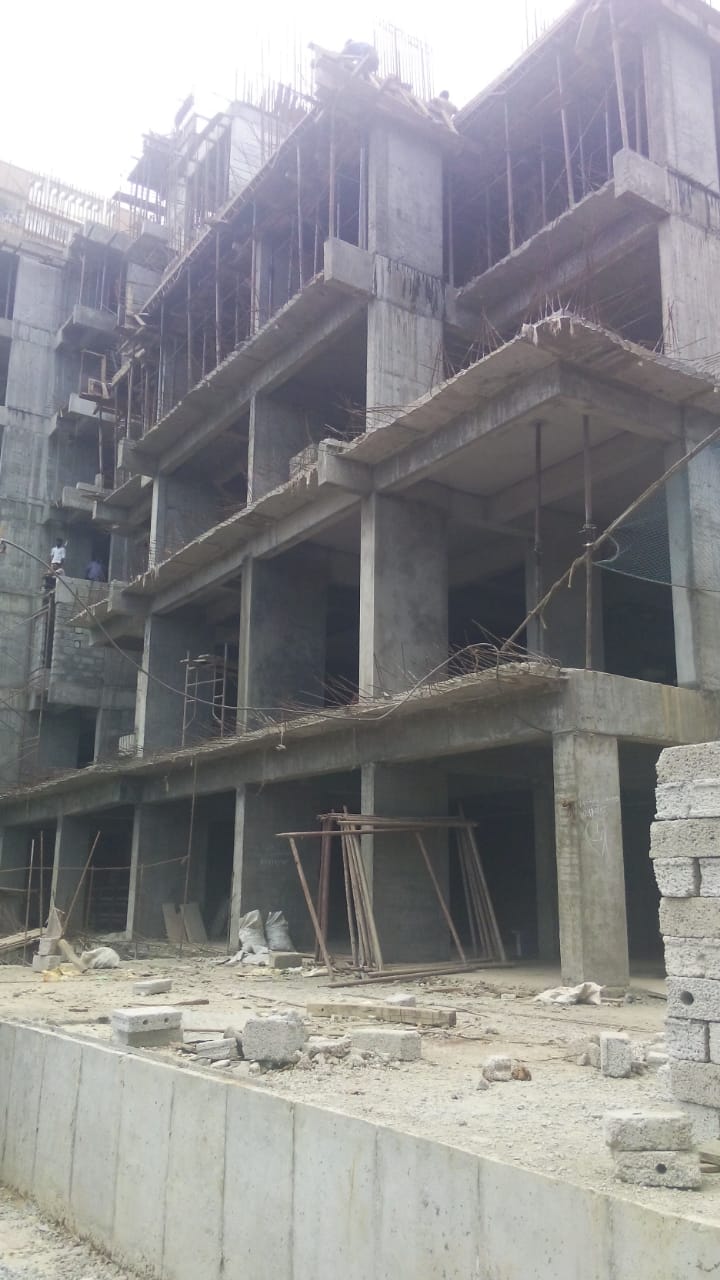

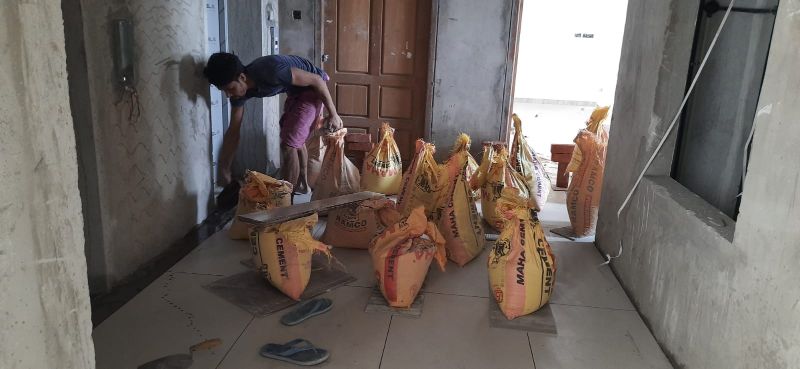

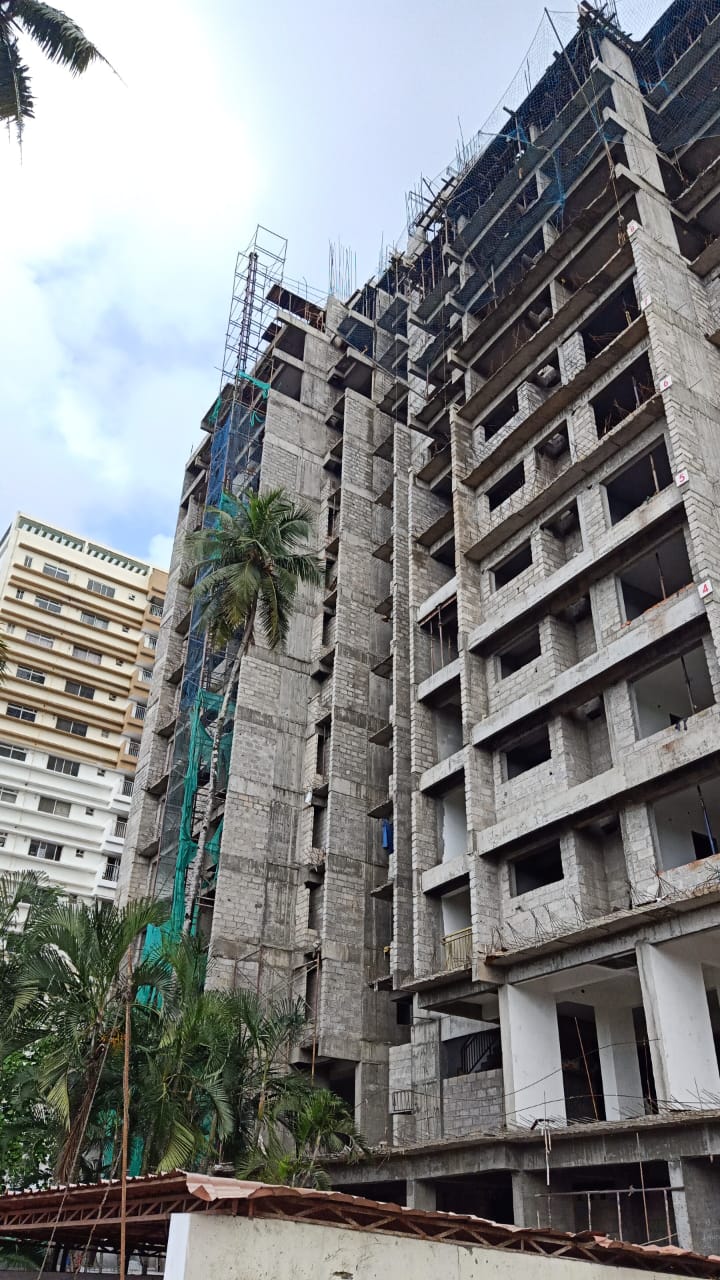

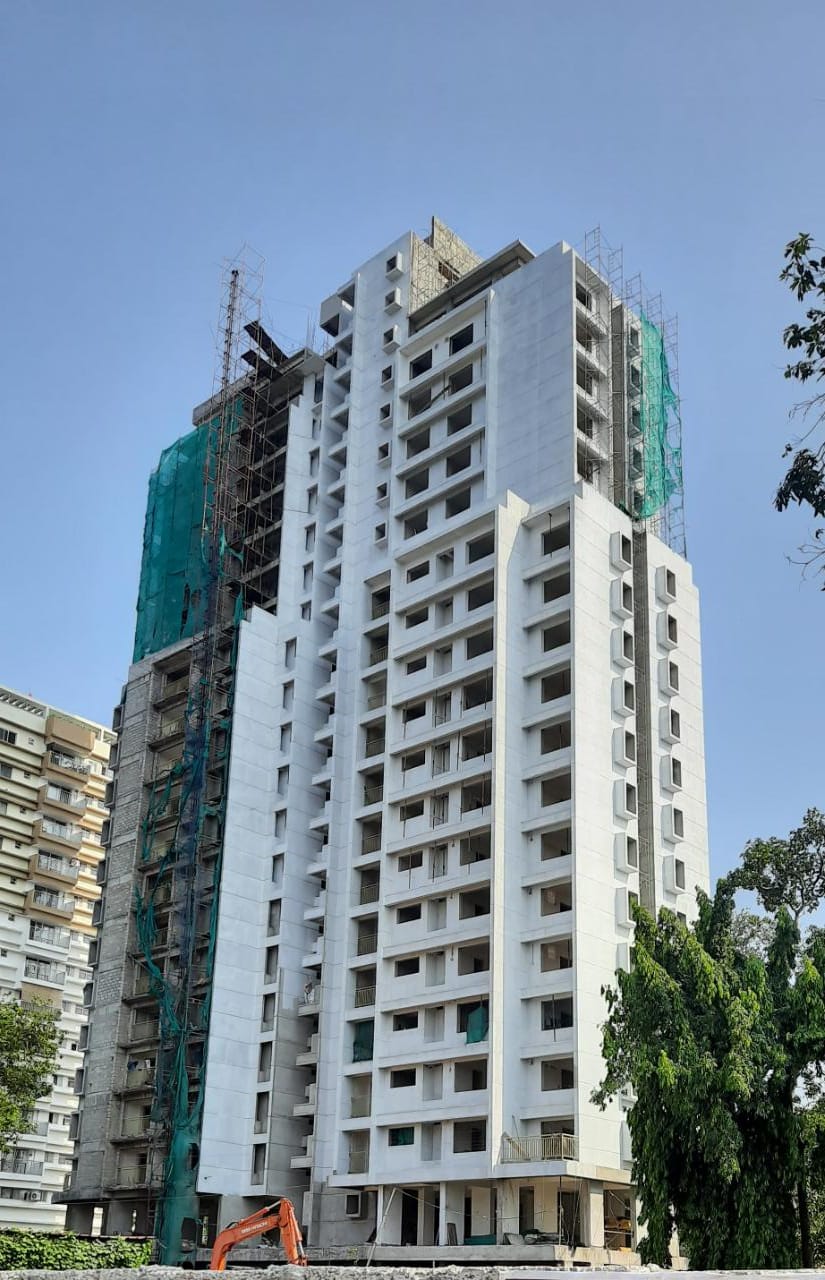

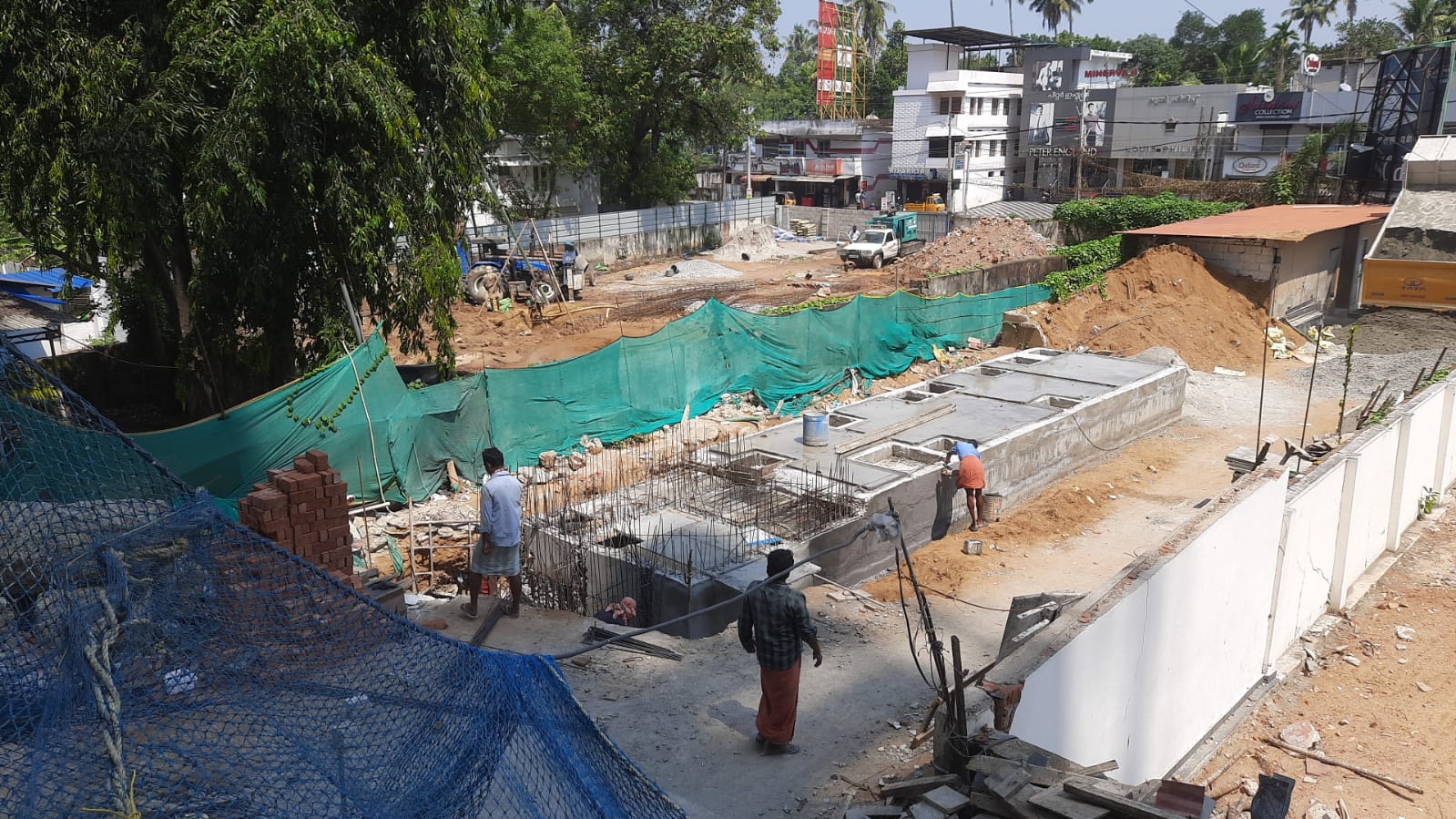

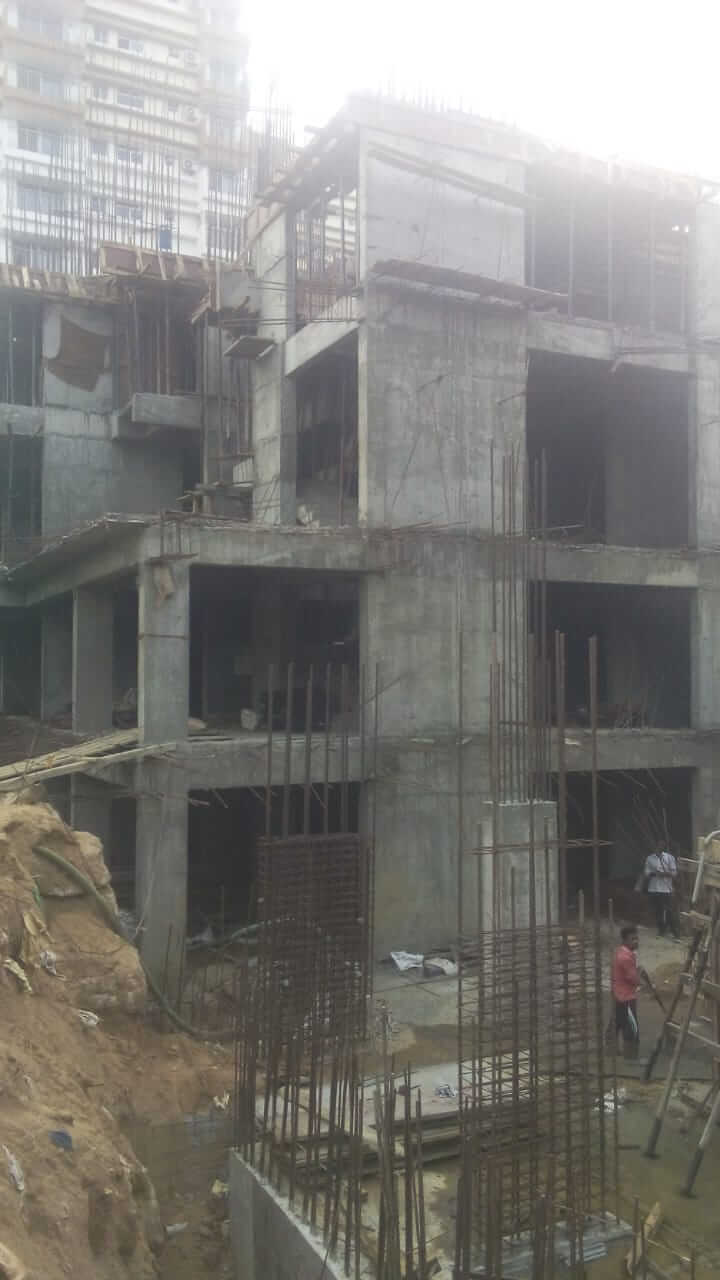

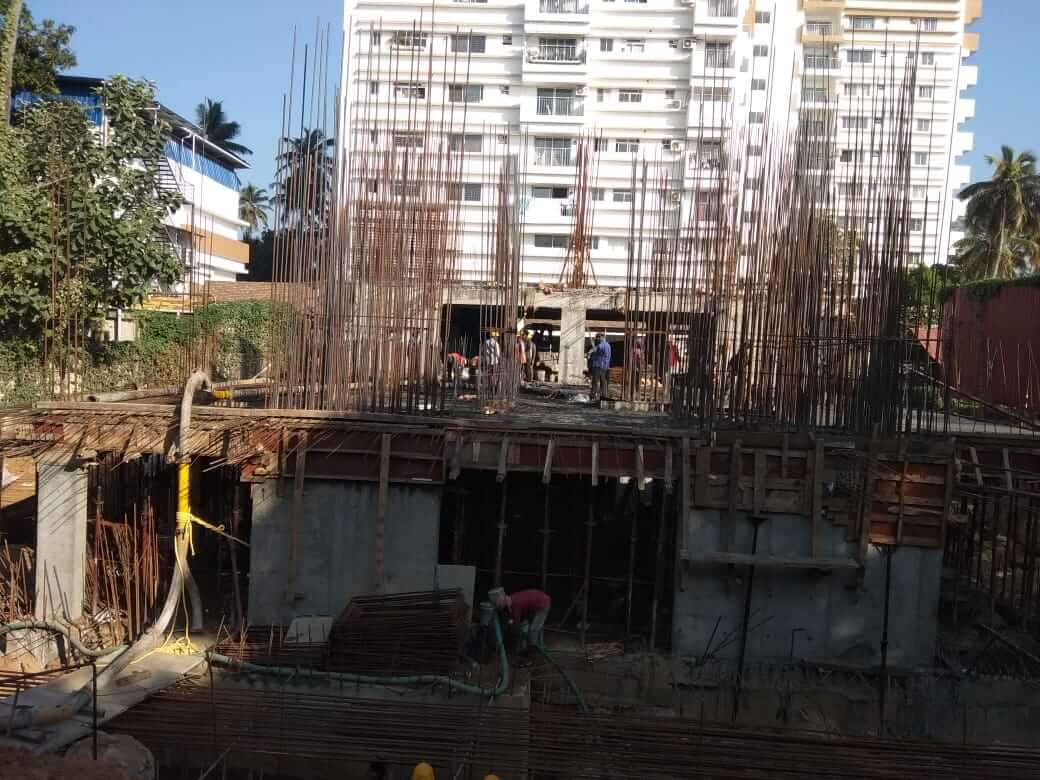

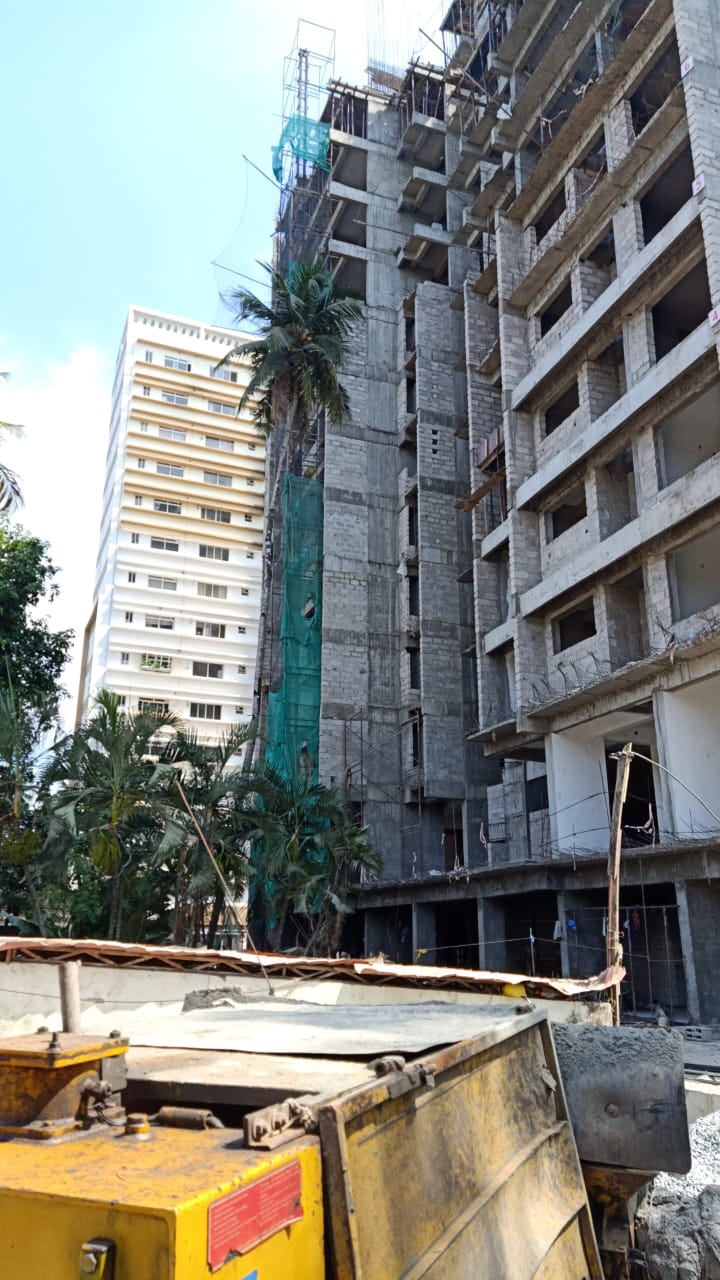

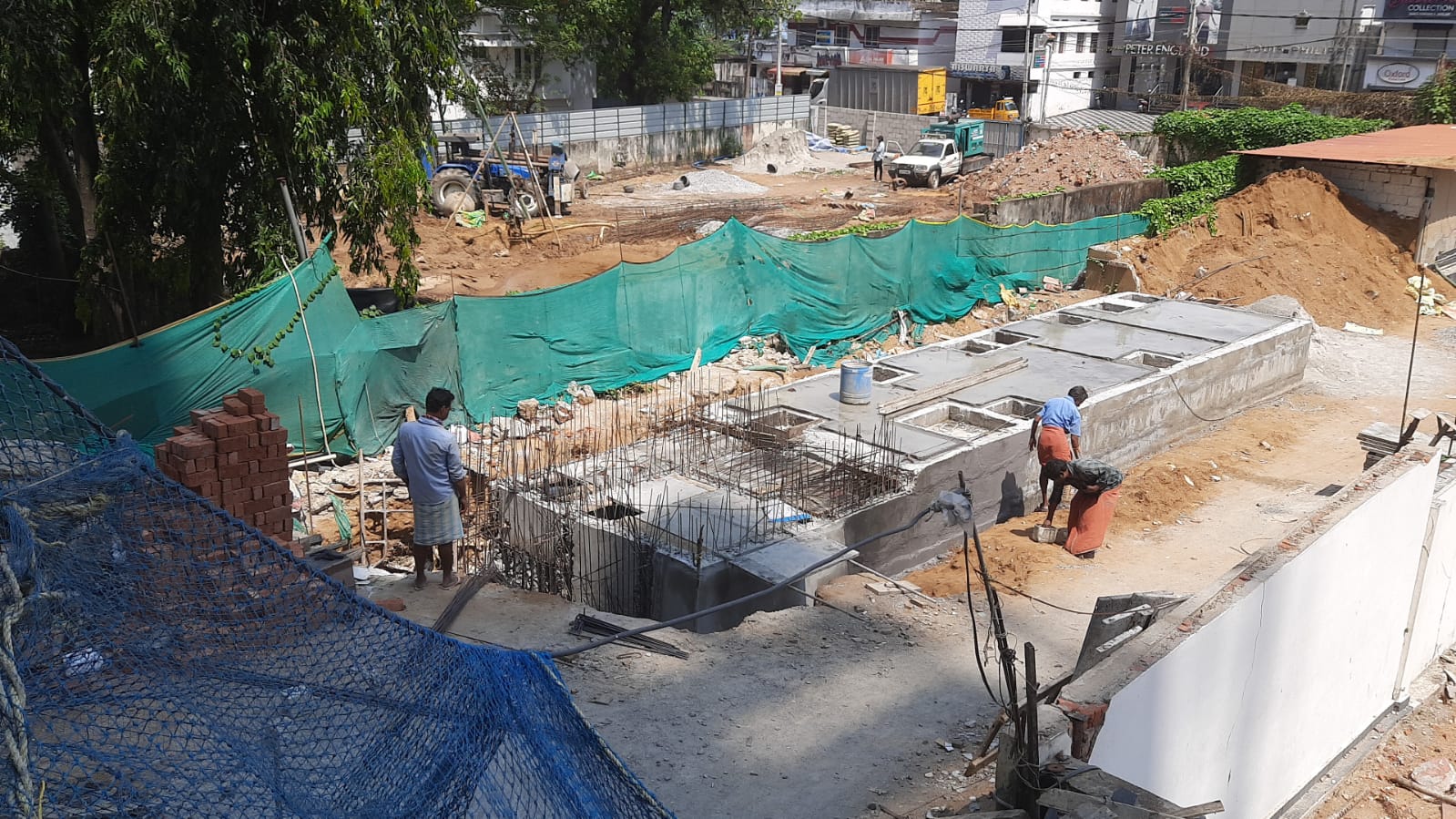

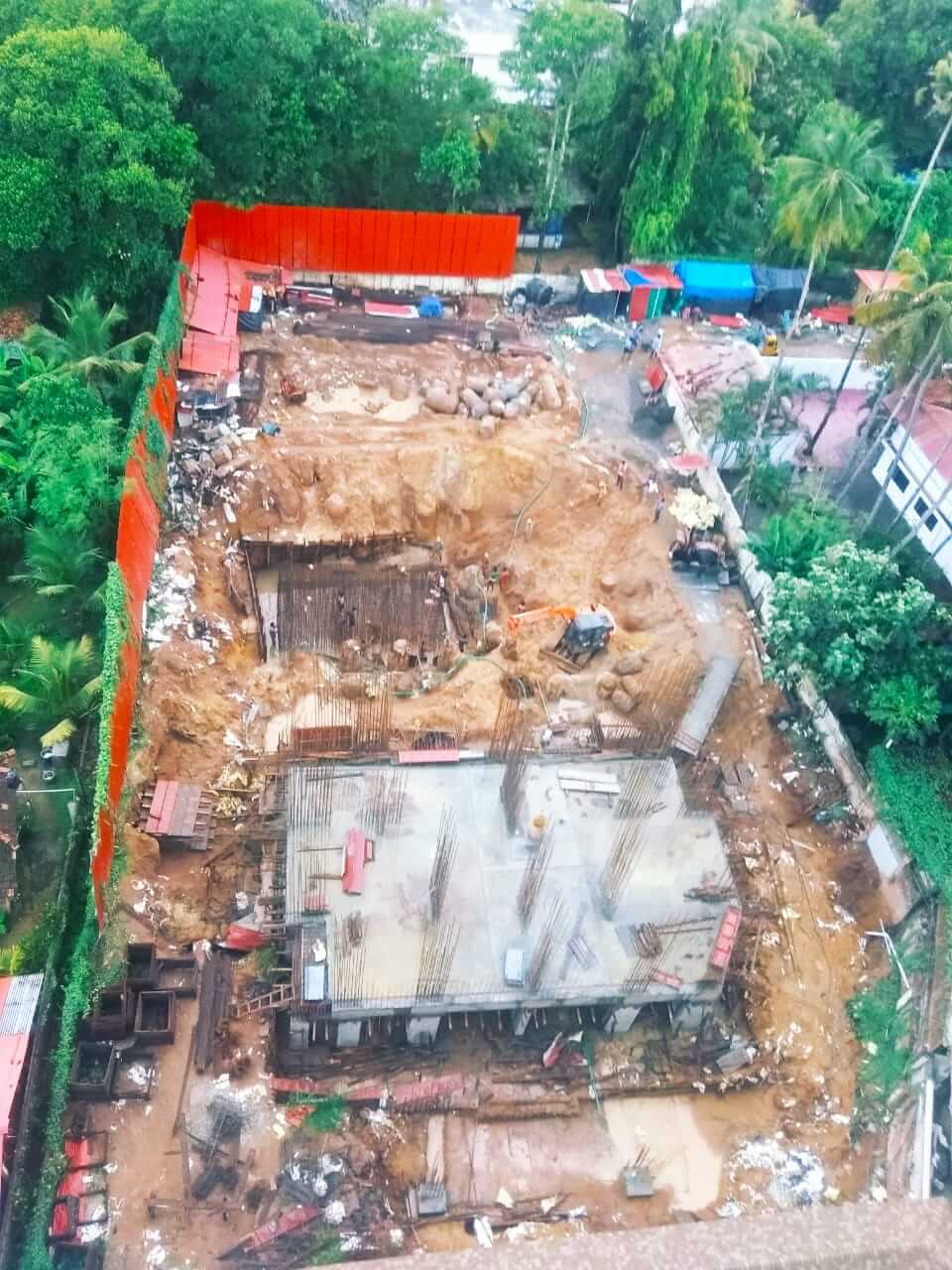

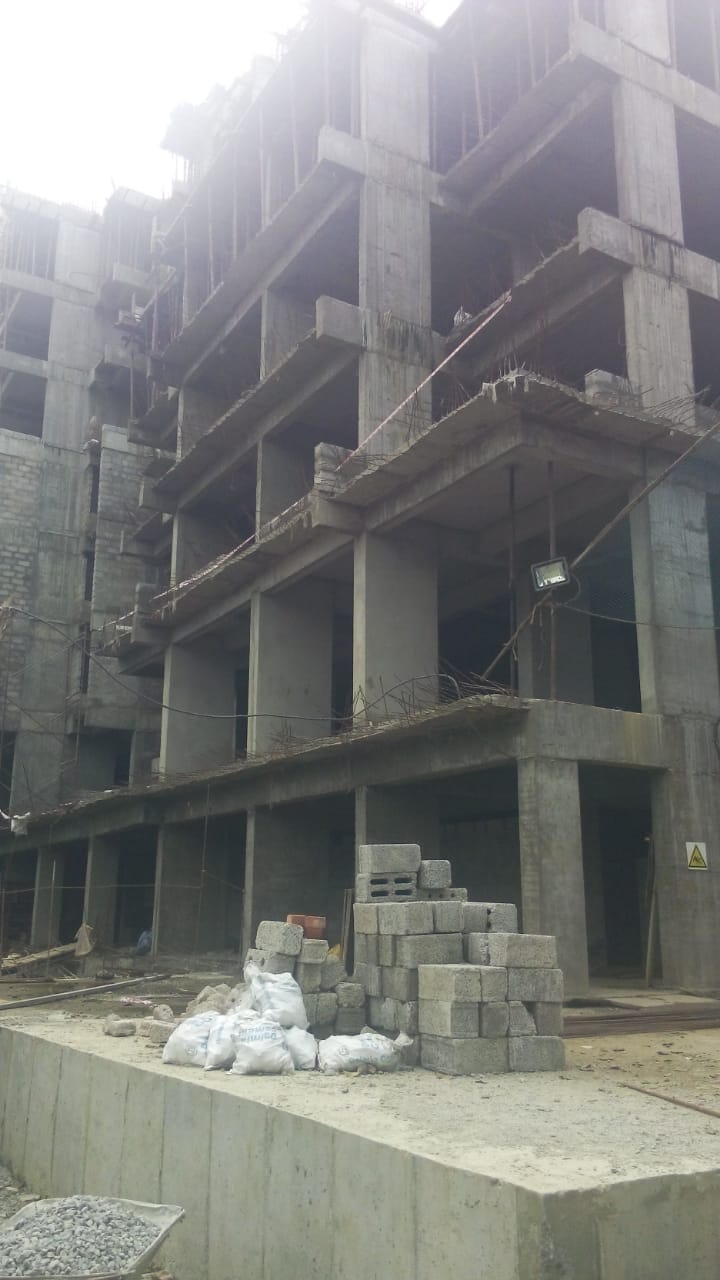

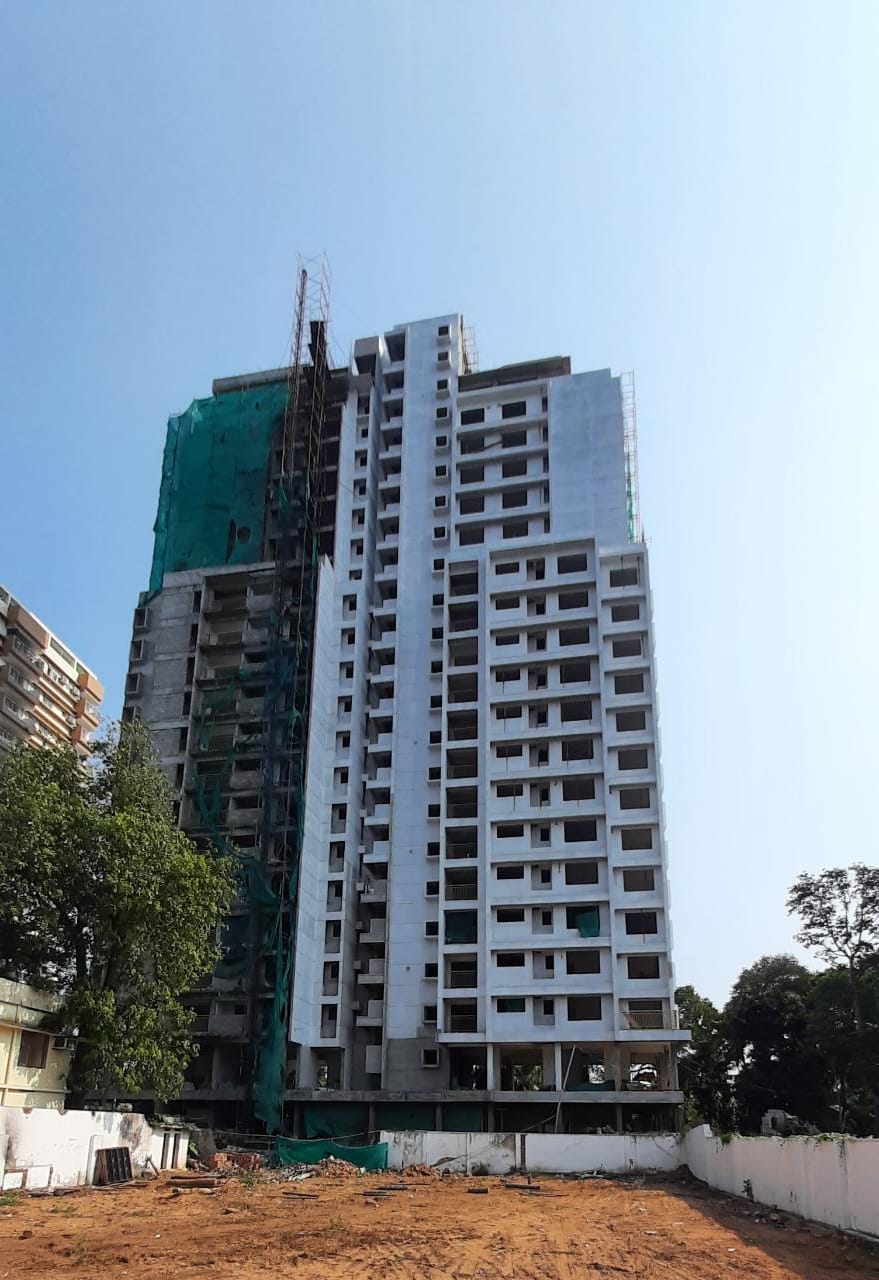

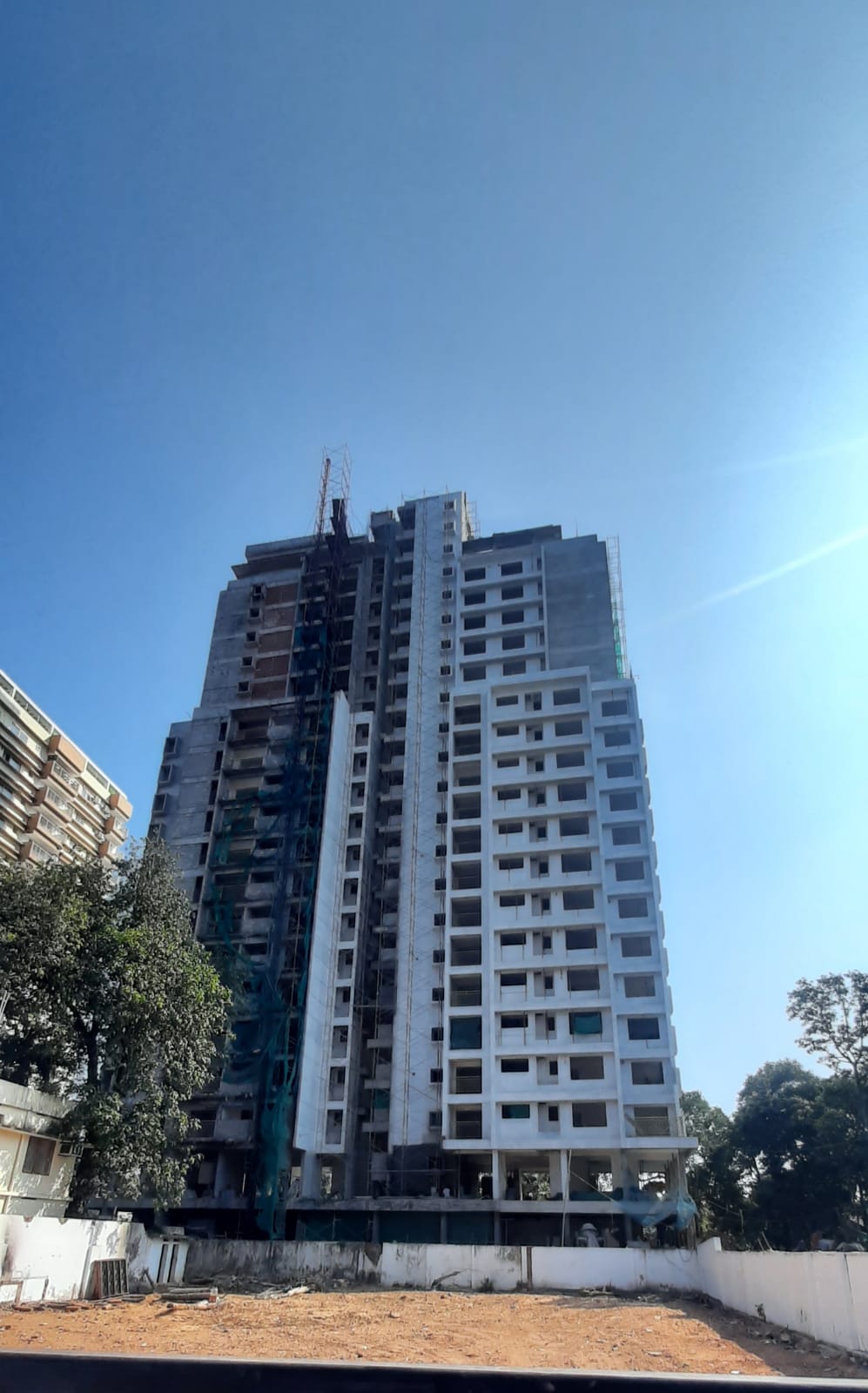

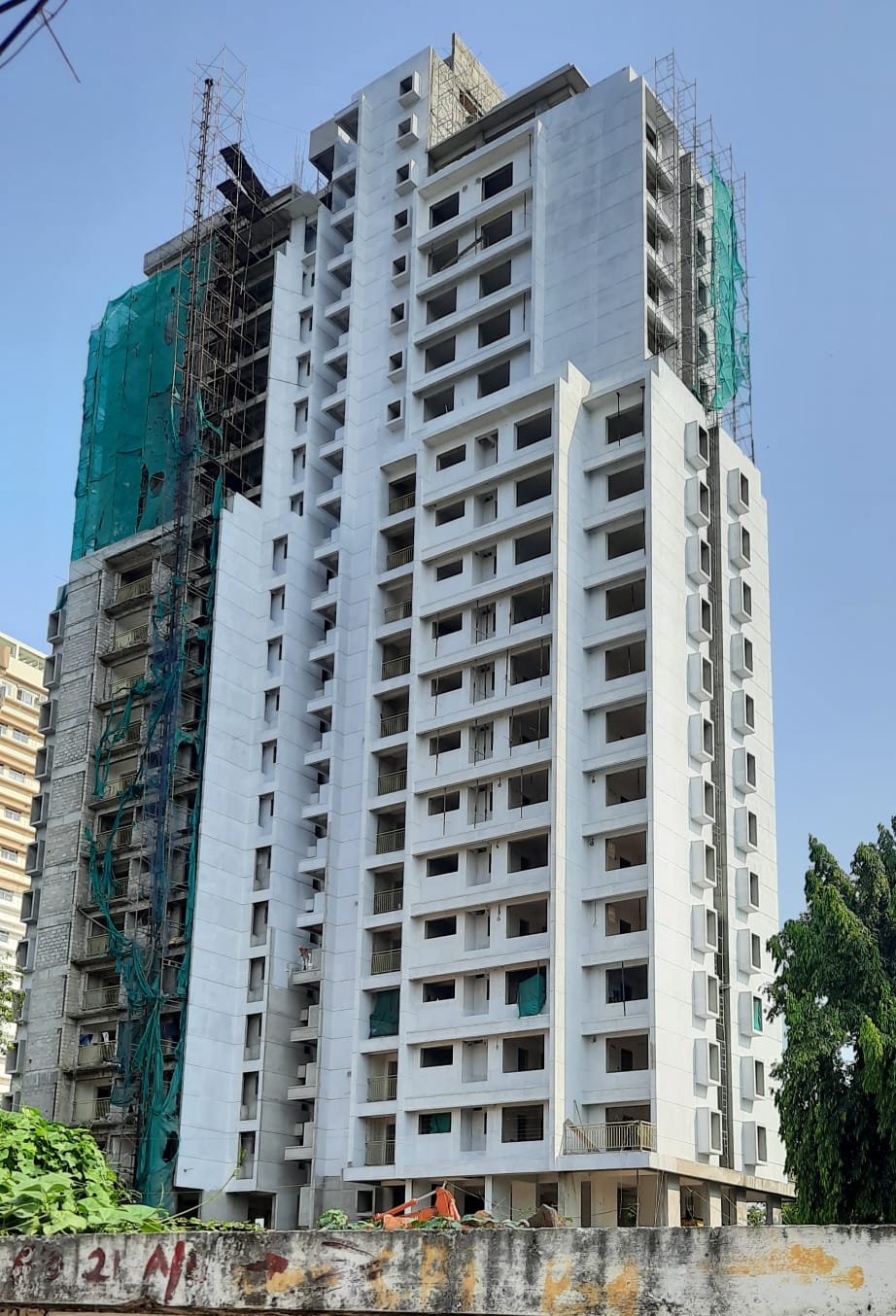

Artech Palm Meadows - Progress

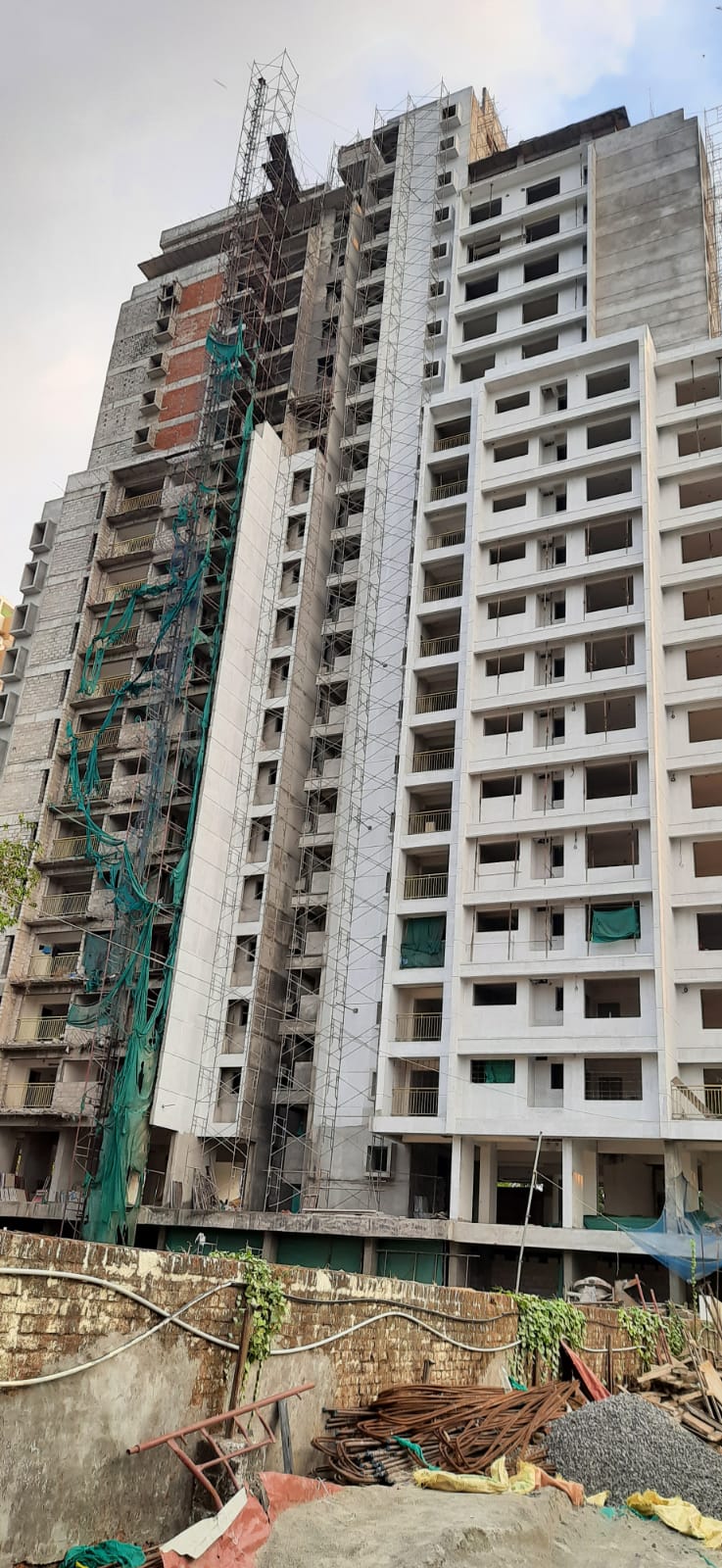

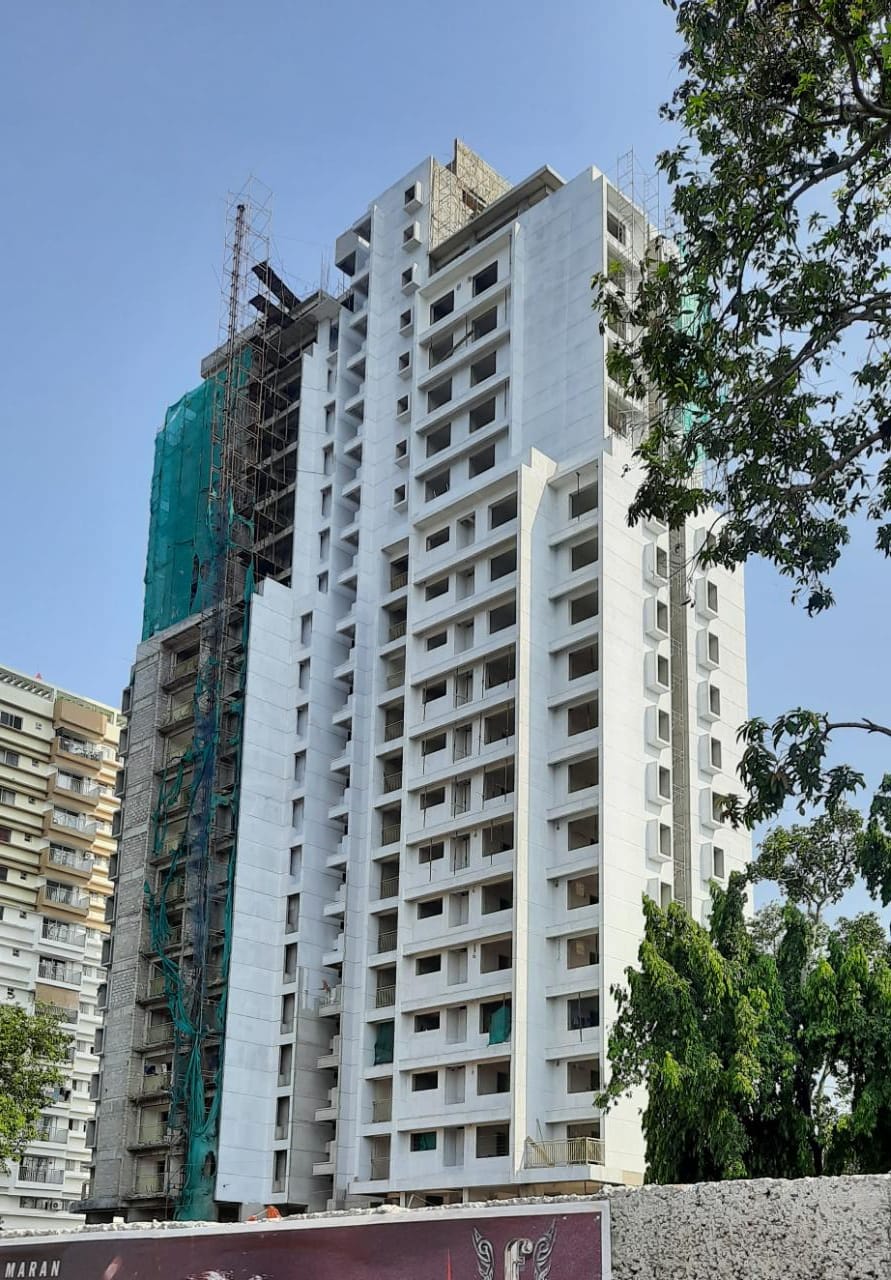

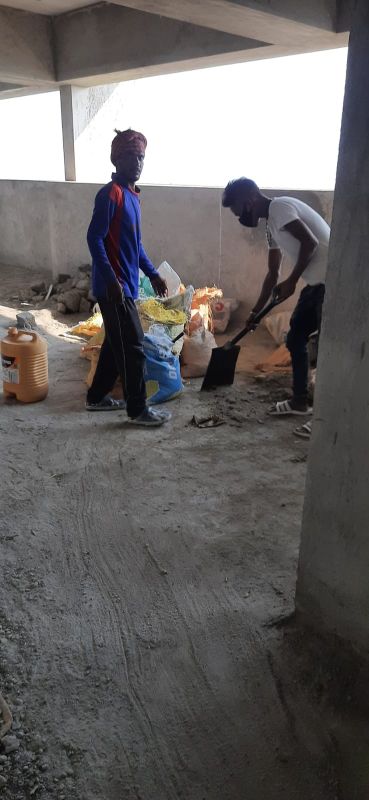

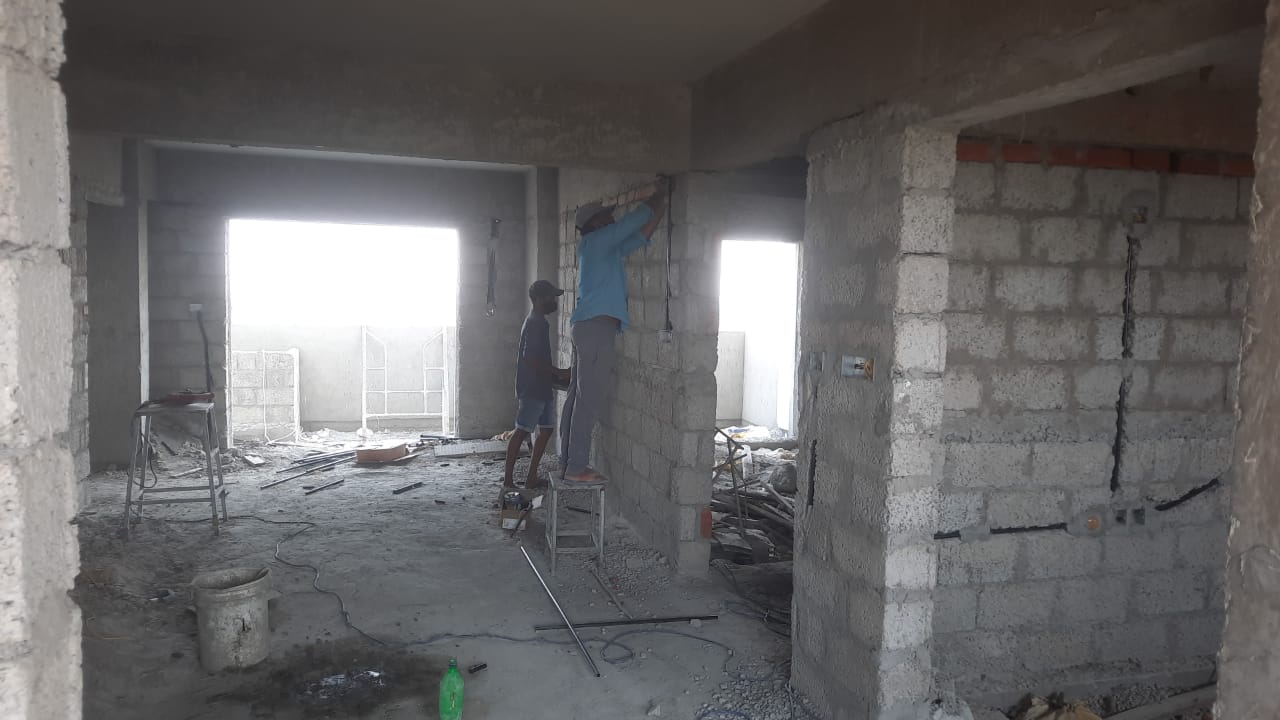

Work status as on 08-03-2022, we have completed the following.
- Structural Works – All Sub-Structural and Structural work 98% Completed, GF north side drive way – 50% completed, ground to basement ramp completed.

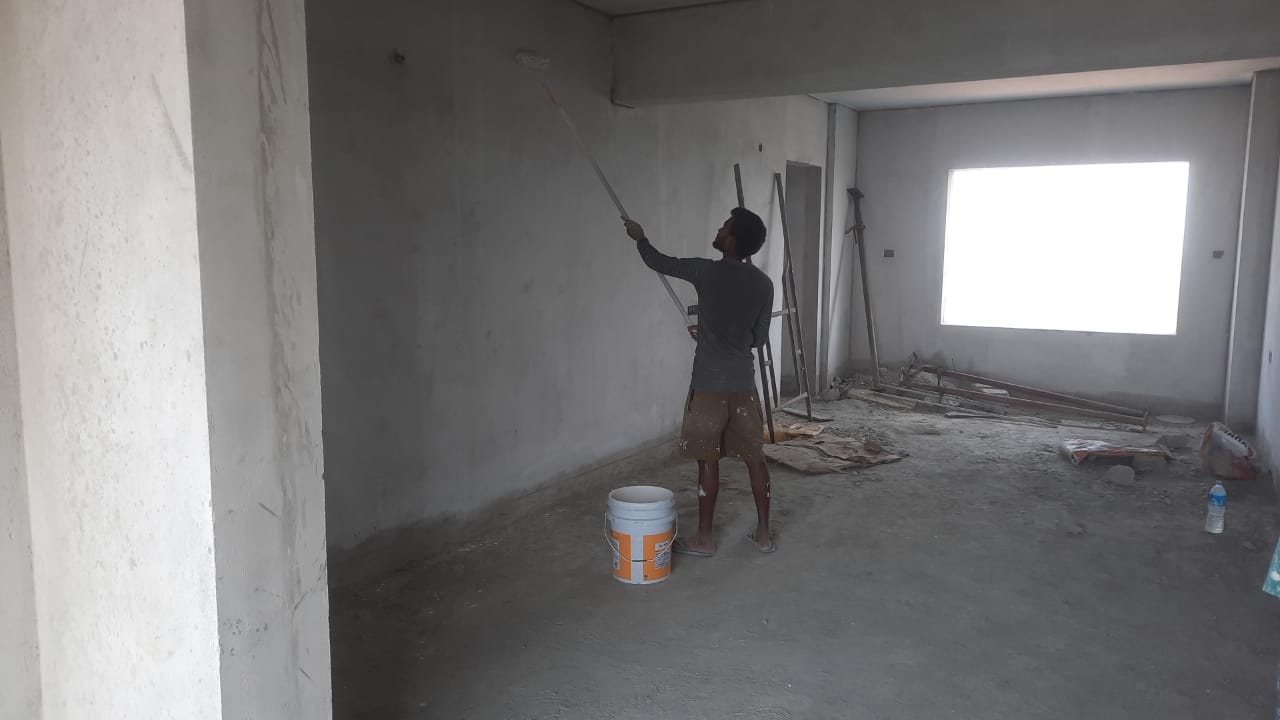

- Civil Works – Ceiling plastering and wall plastering- Inside flat 100% completed, BF ceiling – 50% completed, BF wall plastering – 15% completed, Masonry – Block/ brick- inside flat area completed, Screeding – 75% (till 19th flat inside completed except 14th floor completed) except common area

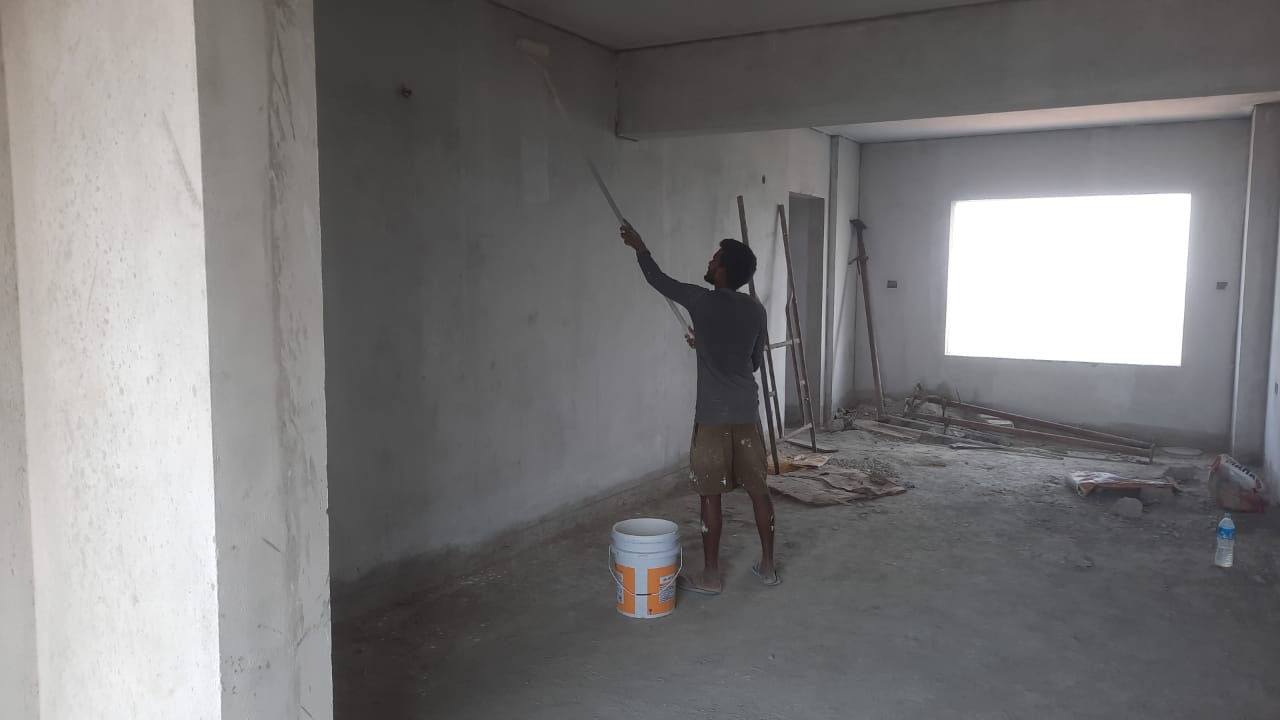

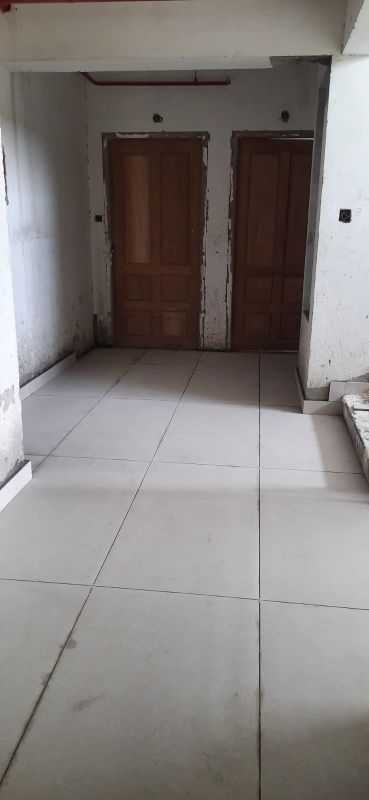

- Internal Finishes – Main door – frame only – 100% completed, Waterproofing up to 19th floor completed, (over head tank – completed, lift well -2, rainwater harvesting tank outside completed, aminety floor water proofing completed, UG Tank – 35% completed, STP – 60% Completed), Wall tiles – up to 13th floor completed, 16th floor completed, 18th floor Completed, Floor Tiling till 18th floor – 70% completed except 14th floor, putty works & inside painting works – 80% completed (2nd coat putty completed, 1 coat primer completed), Handrails – 95% completed (main stair – completed , fire stair -completed, balcony handrail – till 19th floor completed).
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – (93%) – up to 19th floor, Fire fighting works – (GF, 1st to 19th floor completed) 95% completed

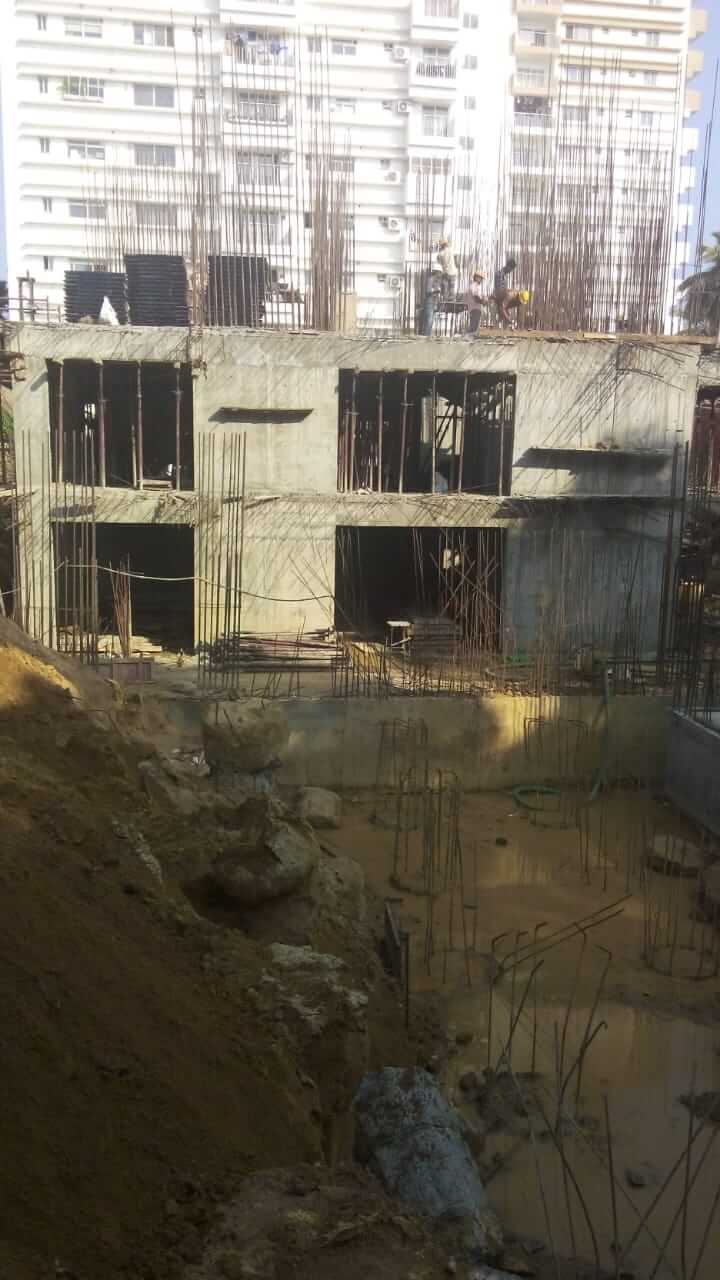

- External Finishes – Windows and sliding door – 2nd to 9 th floor 60% completed , External Plastering – Elevation 2 (100%) & 3 (100%) Completed, Elevation 1 – 92% completed (B Flat portion), Elevation 4 completed, External painting – Elevation 1 Damp proof – 90% completed, first coat putty work completed, 2nd coat putty completed, elevation 2 – damp proof – 80% completed, 1st coat putty 65% completed, elevation 3 – damp proof -50% completed, 1st coat putty – 50% completed, elevation 4 – dramp proof & 1st coat putty completed
- Mockup – Completed.
As per the current work status from our site, we are targeted to complete the following works by the end of MARCH 2022.

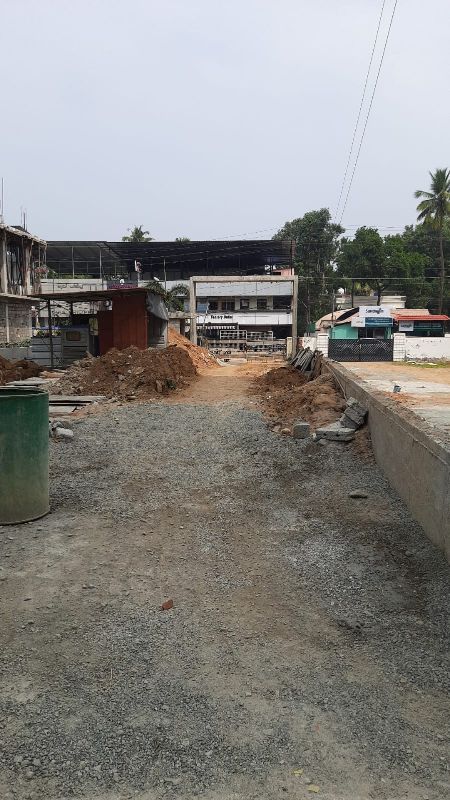

- Structural Works – GF north side drive way 50% more to be Completed.
- Internal Finishes – Waterproofing – UG tank and STP to be completed, flooring – 19th floor , lift lobby common area to be completed, putty works and painting – 85% to be completed, Handrails – 98% to be completed
Work status as on 11-02-2022, we have completed the following.
- Structural Works – All Sub-Structural and Structural work 98% Completed. GF north side drive way – 50% completed, grounf to basement ramp completed.
- Civil Works – Ceiling plastering and wall plastering- Inside flat 100% completed, BF ceiling – 50% completed, BF wall plastering – 15% completed, Masonry – Block/ brick- inside flat area completed, Screeding – 70% (till 19th flat inside completed except 14th floor completed) except common area
- Internal Finishes – Main door – frame only – 100% completed, Waterproofing up to 19th floor completed, (over head tank – completed, lift well -2, rainwater harvesting tank outside completed, aminety floor water proofing completed, UG Tank – 35% completed, STP – 60% Completed), Wall tiles – up to 13th floor completed, 17th floor – 50% completed, 18th floor – 50% Completed, Floor Tiling till 18th floor – 70% completed except 14th floor, putty works & inside painting works – 77% completed (2nd coat putty completed, 1 coat primer completed), Handrails – 90% completed (main stair – completed , fire stair -completed, balcony handrail – till 19th floor completed).
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – (80%) – up to 19th floor, Fire fighting works – (GF, 1st to 19th floor completed) 95% completed
- External Finishes – Windows and sliding door – up to 2nd to 9 th floor 60% completed , External Plastering – Elevation 2 (100%) & 3 (100%) Completed, Elevation 1 – 92% completed (B Flat portion), Elevation 4 completed, External painting – Elevation 1 Damp proof – 90% completed, first coat putty work completed, 2nd coat putty completed, elevation 2 – damp proof – 80% completed, 1st coat putty 65% completed, elevation 3 – damp proof -50% completed, 1st coat putty – 50% completed, elevation 4 – dramp proof & 1st coat putty completed
- Mockup – Completed.
As per the current work status from our site, we are targeted to complete the following works by the end of FEBRUARY 2023.
- Structural Works – GF north side drive way 50% more to be Completed.
- Internal Finishes – Waterproofing – UG tank and STP to be completed, flooring – 19th floor , lift lobby common area to be completed, putty works and painting – 80% to be completed, Handrails – 95% to be completed.
Work status as on 14-01-2022, we have completed the following.
- Structural Works – All Sub-Structural and Structural work 98% Completed. GF north side drive way – 50% completed
- Civil Works – Ceiling plastering and wall plastering- Inside flat 100% completed, Masonry – Block/ brick- inside flat area completed , Screeding – 65% (till 13th floor – 100% completed, 17th,18th, – 50% completed, 19th floor – 50% completed).
- Internal Finishes – Main door – frame only – 100% completed, Waterproofing up to 19th floor completed, (over head tank – completed, lift well -2, rainwater harvesting tank outside completed, aminety floor water proofing completed), Wall tiles – up to 13th floor completed, 17th floor – 50% completed, 18th floor – 50% Completed, 19E Flat wall tile fully completed, Floor Tiling 13th floor 100% completed, 18th floor – 50% completed, putty works & inside painting works – 77% completed (2nd coat putty completed, 1 coat primer completed), Handrails – 87% completed (main stair – till 14 th floor completed , fire stair – till 14 th floor completed, balcony handrail – till 19th floor completed).
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – (70%) – up to 19th floor, Fire fighting works – (GF, 1st to 19th floor completed) 90% completed
- External Finishes – Windows and sliding door – up to 7th floor 70% completed , External Plastering – Elevation 2 (100%) & 3 (98%) Completed, Elevation 1 – 92% completed (B Flat portion), Elevation 4 completed, External painting – Elevation 1 Damp proof – 90% completed, first coat putty work completed, 2nd coat putty completed, elevation 2 – damp proof – 80% completed, 1st coat putty 65% completed, elevation 3 – damp proof -50% completed, 1st coat putty – 50% completed, elevation 4 – dramp proof & 1st coat putty completed
- Mockup – Completed.
As per the current work status from our site, we are targeted to complete the following works by the end of JANUARY 2023.
- Structural Works – Ramp & GF north side drive way 50% more to be Completed.
- Civil Works – Screeding- (16th,17th floor) 50% to be completed
- Internal Finishes – Waterproofing – BF to be completed, wall tile – 17 th,18th floor to be completed, flooring – 16th floor E flat to be completed, putty works and painting – 80% to be completed, Handrails – 90% to be completed
- External Finishes – External Plastering,- Elevation-1 100% to be completed, Elevation 3 100% to be completed, External painting – Damp proof – 40% more to be completed, putty works – 50% more to be completed

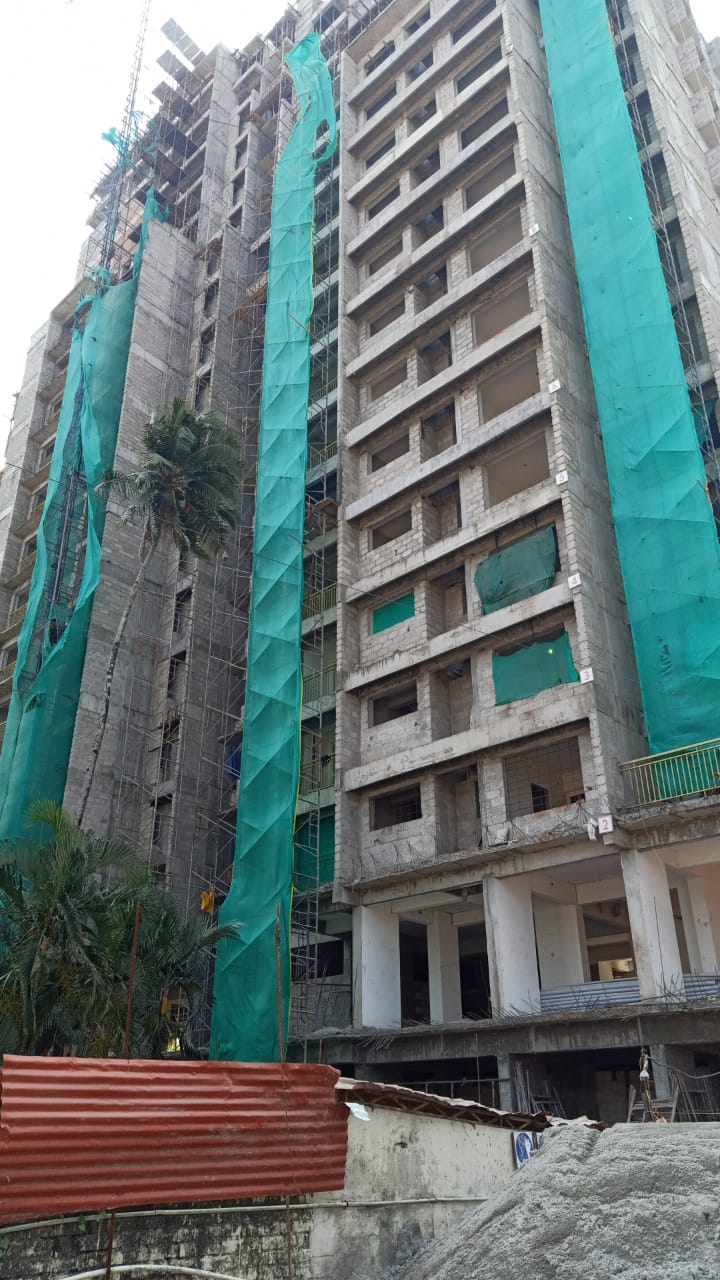

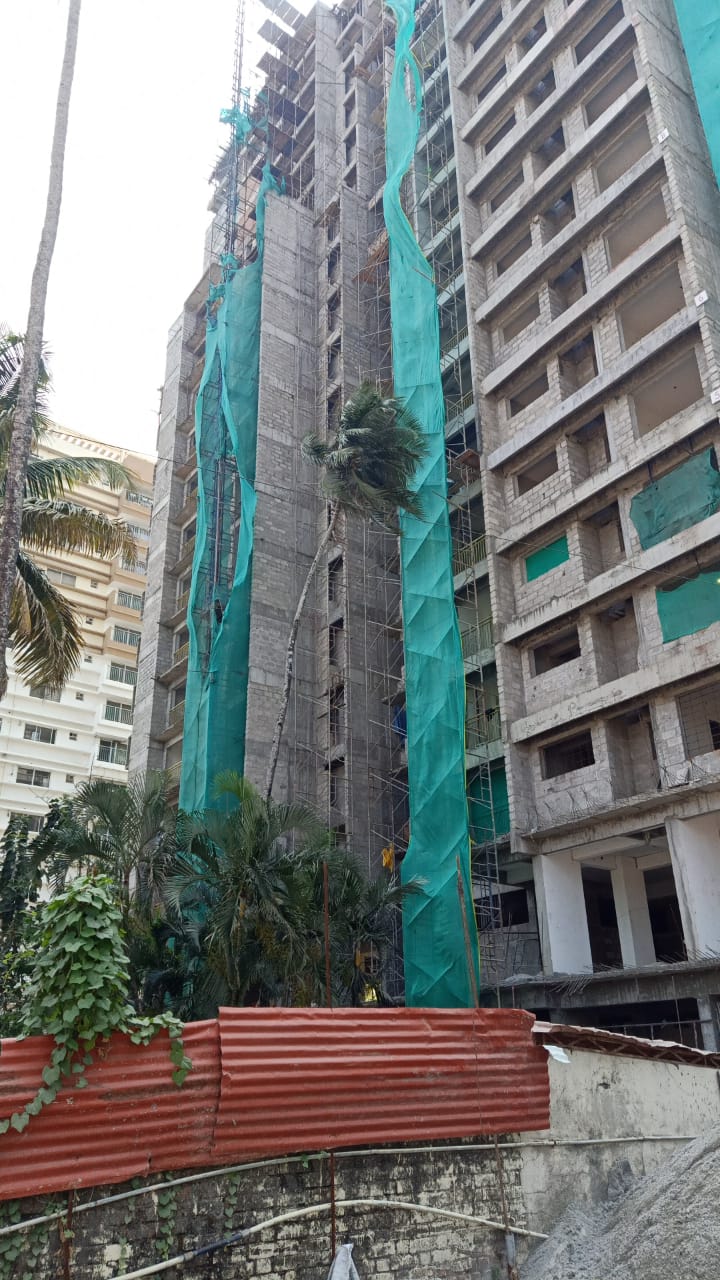

Work status as on 13-12-2022, we have completed the following
As per the current work status from our site, we are targeted to complete the following works by the end of DECEMBER 2022.
- Structural Works – Ramp & GF north side drive way 50% more to be Completed.
- Civil Works – Screeding- (16th,17th floor) 50% to be completed
- Internal Finishes – Waterproofing – up to 19th floor 80% to be completed, wall tile – 16 th floor – 50% to be completed, flooring – 16th floor 50% to be completed, putty works and painting – 80% to be completed, Handrails – 90% to be completed
- External Finishes – External Plastering,- Elevation-1 100% to be completed, Elevation 3 100% to be completed, External painting – Damp proof – 40% more to be completed, putty works – 50% more to be completed
Work status as on 13-12-2022, we have completed the following.
- Structural Works – All Sub-Structural and Structural work 98% Completed. GF north side drive way – 50% completed
- Civil Works – Ceiling plastering and wall plastering- Inside flat 100% completed, Masonry – Block/ brick- inside flat area completed , Screeding – 55% (till 13th floor – 100% completed, 19th floor – 50% completed).
- Internal Finishes – Main door – frame only – 100% completed, Waterproofing up to 19th floor 70% completed, (over head tank – 90% completed, lift well -2, rainwater harvesting tank outside completed), Wall tiles – up to 13th floor completed, 18th floor – 50% Completed, Floor Tiling 13th floor 100% completed, 18th floor – 50% completed, putty works & inside painting works – 77% completed (2nd coat putty completed, 1 coat primer completed), Handrails – 87% completed (main stair – till 14 th floor completed , fire stair – till 14 th floor completed, balcony handrail – till 19th floor completed).
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – (65%) – up to 19th floor, Fire fighting works – (GF, 1st to 19th floor completed) 90% completed
- External Finishes – Windows and sliding door – up to 5th floor 60% completed , External Plastering – Elevation 2 (100%) & 3 (97%) Completed, Elevation 1 – 90% completed (B Flat portion), Elevation 4 completed, External painting – Elevation 1 Damp proof – 90% completed, first coat putty work completed, 2nd coat putty completed, elevation 2 – damp proof – 80% completed, 1st coat putty 65% completed, elevation 3 – damp proof -50% completed, 1st coat putty – 50% completed, elevation 4 – dramp proof & 1st coat putty completed
- Mockup – Completed.
As per the current work status from our site, we are targeted to complete the following works by the end of NOVEMBER 2022.
- Structural Works – Ramp & GF north side drive way 50% more to be Completed.
- Civil Works – Screeding- (14th floor) 100% to be completed
- Internal Finishes – Waterproofing – overhead tank 50% more to be completed, till 19th floor – 75% to be completed, flooring – 14th,15th floor 100% to be completed, putty works and painting – 80% to be completed, Handrails – 90% to be completed
- External Finishes – External Plastering,- Elevation-1 100% to be completed, Elevation 3 100% to be completed, External painting – Damp proof – 40% more to be completed, putty works – 50% more to be completed
Work status as on 15-11-2022, we have completed the following.
- Structural Works – All Sub-Structural and Structural work 98% Completed. GF north side drive way – 50% completed
- Civil Works – Ceiling plastering and wall plastering- Inside flat 100% completed, Masonry – Block/ brick- inside flat area completed , Screeding – 55% (till 13th floor – 100% completed).
- Internal Finishes – Main door – frame only – 100% completed, Waterproofing up to 19th floor 65% completed, (over head tank – 50% completed, lift well -2, rainwater harvesting tank outside completed), Wall tiles – up to 13th floor completed, 18E 20% Completed, Floor Tiling 13th floor 100% completed, putty works & inside painting works – 77% completed (2nd coat putty completed, 1 coat primer completed), Handrails – 87% completed (main stair – till 14 th floor completed , fire stair – till 14 th floor completed, balcony handrail – till 19th floor completed).
- Electrical, Plumbing & Firefighting works – Concealed plumbing works- (60%) – up to 13th floor completed, 14th, 15th floor, 16th, 17th floor – 50% completed, Fire fighting works – (GF, 1st to 19th floor completed) 85% completed
- External Finishes – Windows and sliding door – up to 5th floor 60% completed , External Plastering – Elevation 2 (100%) & 3 (97%)Completed, Elevation 1 – 90% completed (B Flat portion), Elevation 4 completed, External painting – Elevation 1 Damp proof – 90% completed, first coat putty work completed, 2nd coat putty completed, elevation 2 – damp proof – 80% completed, 1st coat putty 65% completed, elevation 3 – damp proof -50% completed, 1st coat putty – 50% completed, elevation 4 – dramp proof & 1st coat putty completed
- Mockup – Completed.
Work status as on 10-11-2022, we have completed the following.
- Structural Works – All Sub-Structural and Structural work 98% Completed. GF north side drive way – 50% completed
- Civil Works – Ceiling plastering and wall plastering- Inside flat 100% completed, Masonry – Block/ brick- inside flat area completed , Screeding – 55% (till 13th floor – 100% completed).
- Internal Finishes – Main door – frame only – 100% completed, Waterproofing up to 19th floor 65% completed, (over head tank – 40% completed, lift well -2, rainwater harvesting tank outside completed), Wall tiles – up to 13th floor completed, Floor Tiling 13th floor 100% completed, putty works & inside painting works – 77% completed (2nd coat putty completed, 1 coat primer completed), Handrails – 87% completed (main stair – till 14 th floor completed , fire stair – till 14 th floor completed, balcony handrail – till 19th floor completed).
- Electrical, Plumbing & Firefighting works – Concealed plumbing works- (60%) – up to 13th floor completed, 14th, 15th floor – 50% completed, Fire fighting works – (GF, 1st to 19th floor completed) 80% completed
- External Finishes – Windows and sliding door – 2nd floor (B Flat), 3rd Floor (C,D,B), 5th Floor (A,B,C,D) completed , External Plastering – Elevation 2 (100%) & 3 (97%)Completed, Elevation 1 – 90% completed (B Flat portion), Elevation 4 completed, External painting – Elevation 1 Damp proof – 90% completed, first coat putty work completed, 2nd coat putty completed, elevation 2 – damp proof – 80% completed, 1st coat putty 65% completed, elevation 3 – damp proof -50% completed, 1st coat putty – 50% completed, elevation 4 – dramp proof & 1st coat putty completed
- Mockup – Completed.
As per the current work status from our site, we are targeted to complete the following works by the end of OCTOBER 2022.
- Structural Works – Ramp & GF north side drive way 50% more to be Completed.
- Civil Works – Screeding- (14th floor) 100% to be completed
- Internal Finishes – Waterproofing – overhead tank 50% to be completed, till 19th floor – 75% to be completed, flooring – 14th,15th floor 100% to be completed, putty works and painting – 80% to be completed, Handrails – 90% to be completed
- Electrical, Plumbing & Firefighting works – fire fighting works – 85% to be completed
- External Finishes – External Plastering,- Elevation-1 100% to be completed, Elevation 3 100% to be completed, External painting – Damp proof – 40% more to be completed, putty works – 50% more to be completed

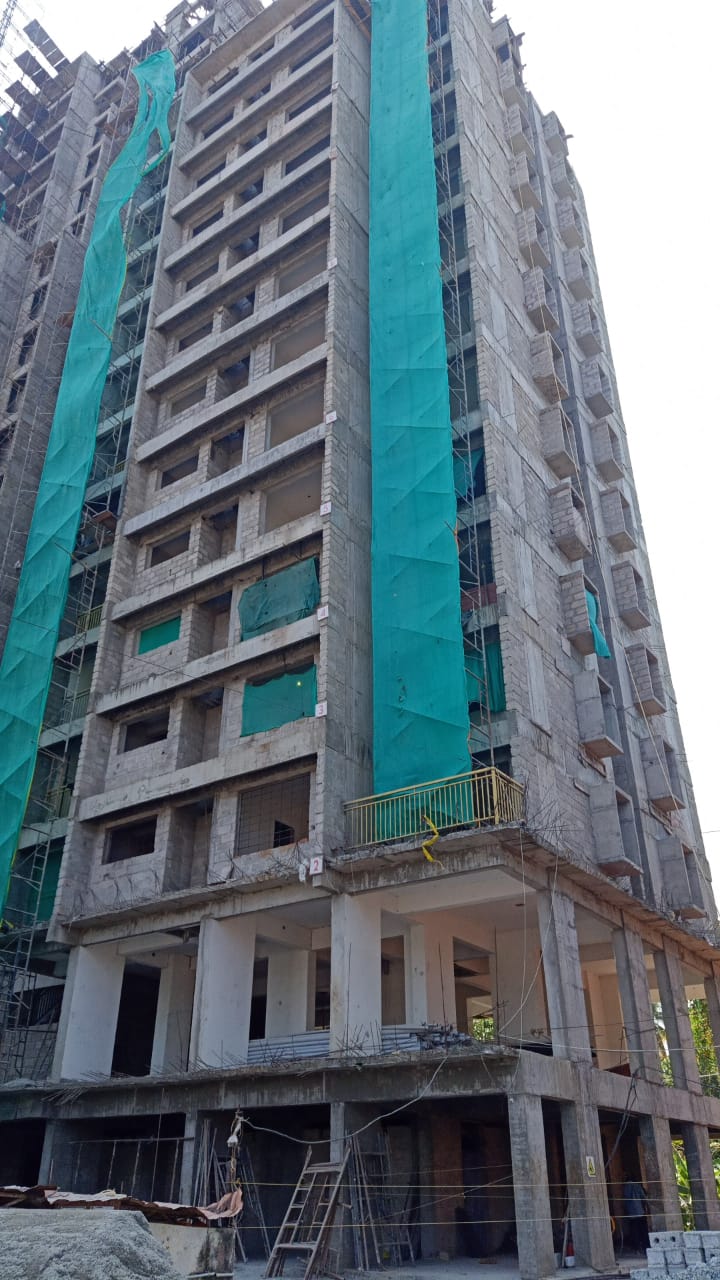

Work status as on 17-09-2022, we have completed the following.
- Structural Works – All Sub-Structural and Structural work 98% Completed. GF north side drive way – 50% completed
- Civil Works – Ceiling plastering and wall plastering- Inside flat 100% completed, Masonry – Block/ brick- inside flat area completed , Screeding – 55% (till 13th floor – 100% completed).
- Internal Finishes – Main door – frame only – 100% completed, Waterproofing up to 13th floor completed, (over head tank – 40% completed, lift well -2, rainwater harvesting tank outside completed), Wall tiles – up to 13th floor completed, Floor Tiling 12th floor -50%, 13th floor – 50% completed, putty works & inside painting works – 77% completed (2nd coat putty completed, 1 coat primer completed), Handrails – 87% completed (main stair – till 14 th floor completed , fire stair – till 14 th floor completed, balcony handrail – till 19th floor completed).
- Electrical, Plumbing & Firefighting works – Concealed plumbing works- up to 13th floor, Fire fighting works – (1st to 19th floor completed) 70% completed
- External Finishes – Windows and sliding door – mockup only, External Plastering – Elevation 2 (100%) & 3 (97%)Completed, Elevation 1 – 90% completed, Elevation 4 completed, External painting – Elevation 1 Damp proof – 90% completed, first coat putty work – 70% completed, elevation 2 – damp proof – 80% completed, 1st coat putty 65% completed, elevation 3 – damp proof -50% completed, 1st coat putty – 50% completed, elevation 4 – dramp proof & 1st coat putty completed
- Mockup – Completed.
As per the current work status from our site, we are targeted to complete the following works by the end of SEPTEMBER 2022.
- Structural Works – Ramp & GF north side drive way 50% more to be Completed.
- Civil Works – Screeding- (14th floor) 100% to be completed
- Internal Finishes – Waterproofing – overhead tank 50% to be completed, flooring – 12th,13th 100% to be completed, putty works and painting – 80% to be completed, Handrails – 90% to be completed
- Electrical, Plumbing & Firefighting works – fire fighting works – 80% to be completed
- External Finishes – External Plastering,- Elevation-1 100% to be completed, Elevation 3 100% to be completed, External painting – Damp proof – 40% more to be completed, putty works – 50% more to be completed
Work status as on 09-07-2022, we have completed the following.
- Structural Works – All Sub-Structural and Structural work 98% Completed. GF north side drive way – 50% completed
- Civil Works – Ceiling plastering and wall plastering- Inside flat 100% completed, Masonry – Block/ brick- inside flat area completed , Screeding – 45% (till 10th floor – 100% completed).
- Internal Finishes – Main door – frame only -100% completed, Waterproofing up to 13th floor completed, (lift well -2, rainwater harvesting tank outside completed), Wall tiles – up to 11th floor completed, Floor Tiling up to 10th floor inside flat area completed, putty works & inside painting works – 72% completed (2nd coat putty completed, 1 coat primer completed), Handrails – 87% completed (main stair – till 14 th floor completed , fire stair – till 14 th floor completed, balcony handrail – till 19th floor completed).
- Electrical, Plumbing & Firefighting works – Concealed plumbing works- up to 13th floor, 18th floor completed, Fire fighting works – (2nd, 3rd, 5th, 6th floor – 70% completed) 20% completed
- External Finishes – Windows and sliding door – mockup only, External Plastering – Elevation 2 (100%) & 3 (97%)Completed, Elevation 1 – 90% completed, Elevation 4 completed, External painting – Elevation 1 Damp proof – 90% completed, first coat putty work – 70% completed, elevation 2 – damp proof – 80% completed, 1st coat putty 65% completed, elevation 3 – damp proof -50% completed, 1st coat putty – 50% completed, elevation 4 – dramp proof & 1st coat putty completed
- Mockup – Completed.
As per the current work status from our site, we are targeted to complete the following works by the end of JULY 2022.
- Structural Works – Ramp & GF north side drive way 50% more to be Completed.
- Civil Works – Screeding- (11th – 13th floor) 100% to be completed
- Internal Finishes – Waterproofing – overhead tank 100% to be completed, wall tile – 12th, 13th floor 100% to be completed, Flooring 11th – 13th floor 100% to be completed, putty works and painting – 80% to be completed, Handrails – 90% to be completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing works- 14th, 15th floor 100% to be completed, fire fighting works – 30% to be completed
- External Finishes – External Plastering,- Elevation-1 100% to be completed, Elevation 3 100% to be completed, External painting – Damp proof – 40% more to be completed, putty works – 50% more to be completed

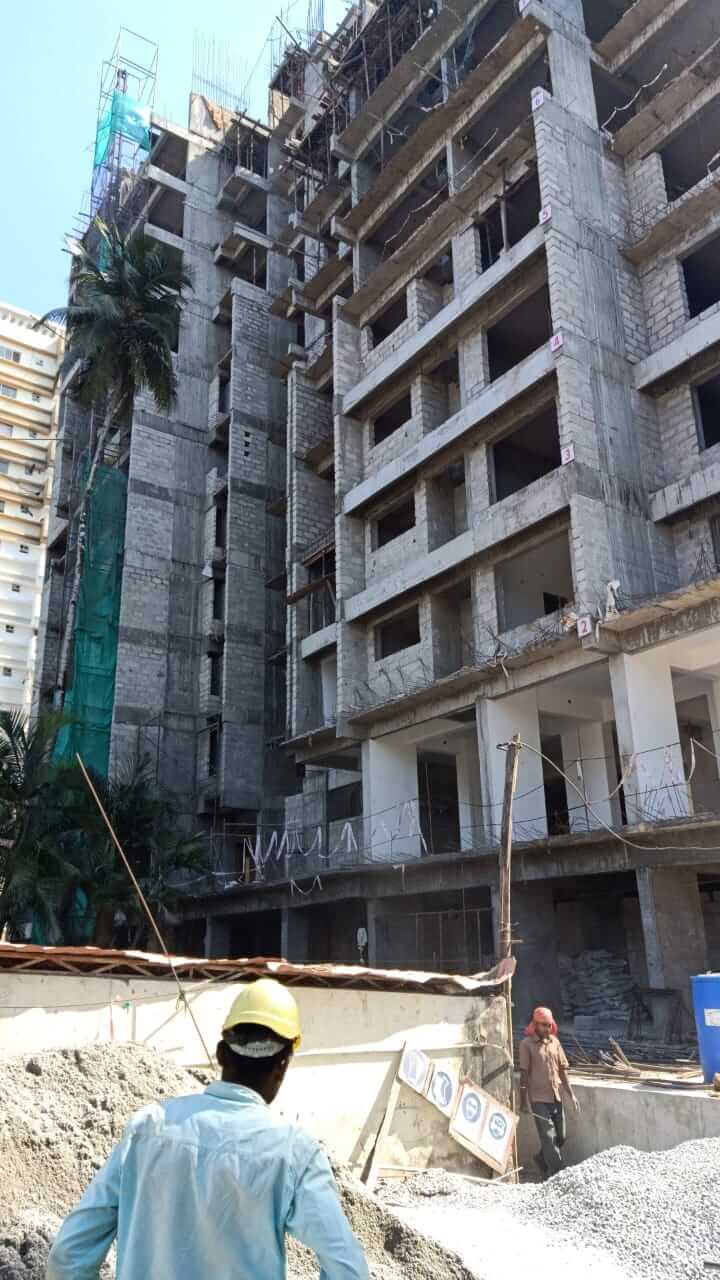

Work status as on 11-06-2022, we have completed the following.
- Structural Works – All Sub-Structural and Structural work 98% Completed. GF north side drive way – 50% completed
- Civil Works – Ceiling plastering and wall plastering- Inside flat 100% completed, Masonry – Block/ brick- inside flat area completed , Screeding – 40% (till 7th floor – 100% completed).
- Internal Finishes – Main door – frame only -100% completed, Waterproofing up to 13th floor completed, Wall tiles – up to 8th floor completed, Floor Tiling up to 7th floor inside flat area completed, putty works & inside painting works – 65% completed (2nd coat putty up to 19th floor inside flat area completed). Handrails-85% completed (main stair – till 12 th floor completed , fire stair – till 13 th floor completed, balcony handrail – till 19th floor completed).
- Electrical, Plumbing & Firefighting works – Concealed plumbing works- up to 13th floor, 18th floor – 30% completed completed, Fire fighting works – 10% completed
- External Finishes – Windows and sliding door – mockup only, External Plastering,-Elevation 2 (100%) & 3 (95%)Completed, Elevation 1- 85% completed, Elevation 4 completed, External painting – Damp proof – 40% completed, putty works – 35% completed
- Mockup – Completed.
As per the current work status from our site, we are targeted to complete the following works by the end of MAY 2022.
- Structural Works – Ramp & GF north side drive way 50% more to be Completed.
- Civil Works – Screeding- 8th floor 100% to be completed
- Internal Finishes – Waterproofing-14th floor 100% to be completed, Flooring 8th floor 100% to be completed, putty works and painting – 70% to be completed, Handrails – 90% to be completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing works- 18th floor 100% to be completed, fire fighting works – 20% to be completed
- External Finishes – External Plastering,- Elevation-1 100% to be completed, Elevation 3 100% to be completed, External painting – Damp proof – 50% to be completed, putty works – 50% to be completed

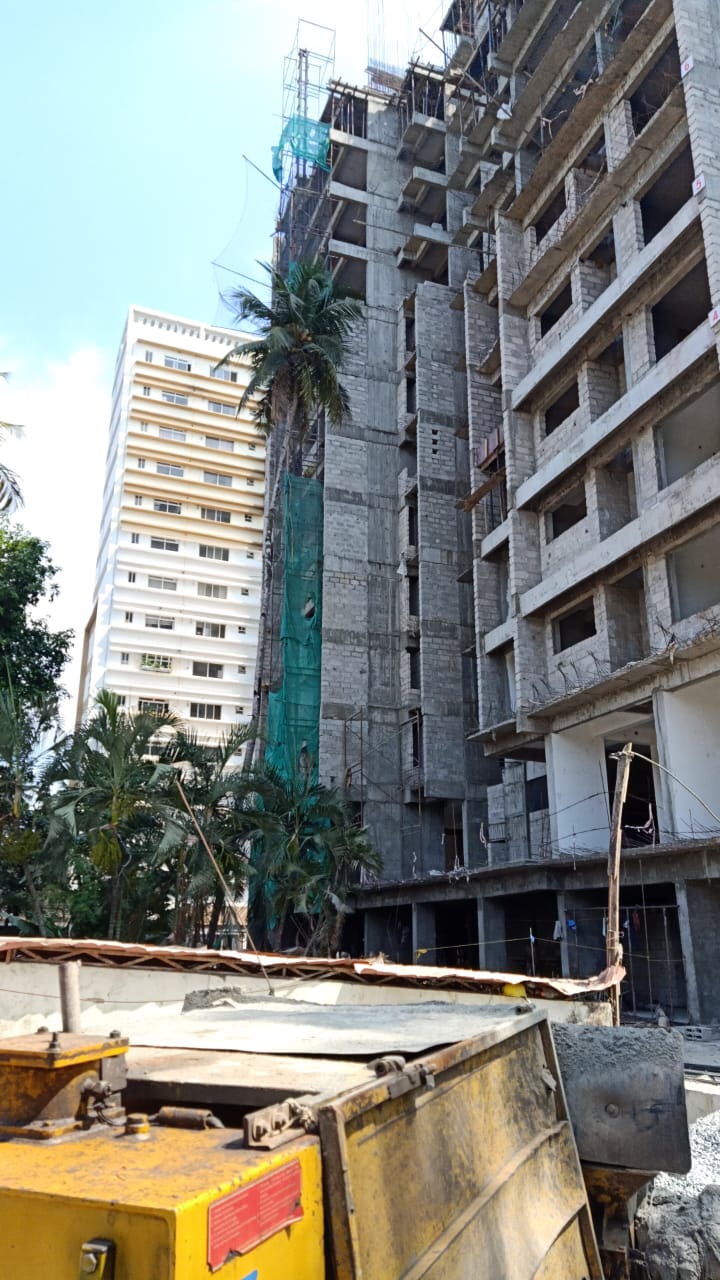

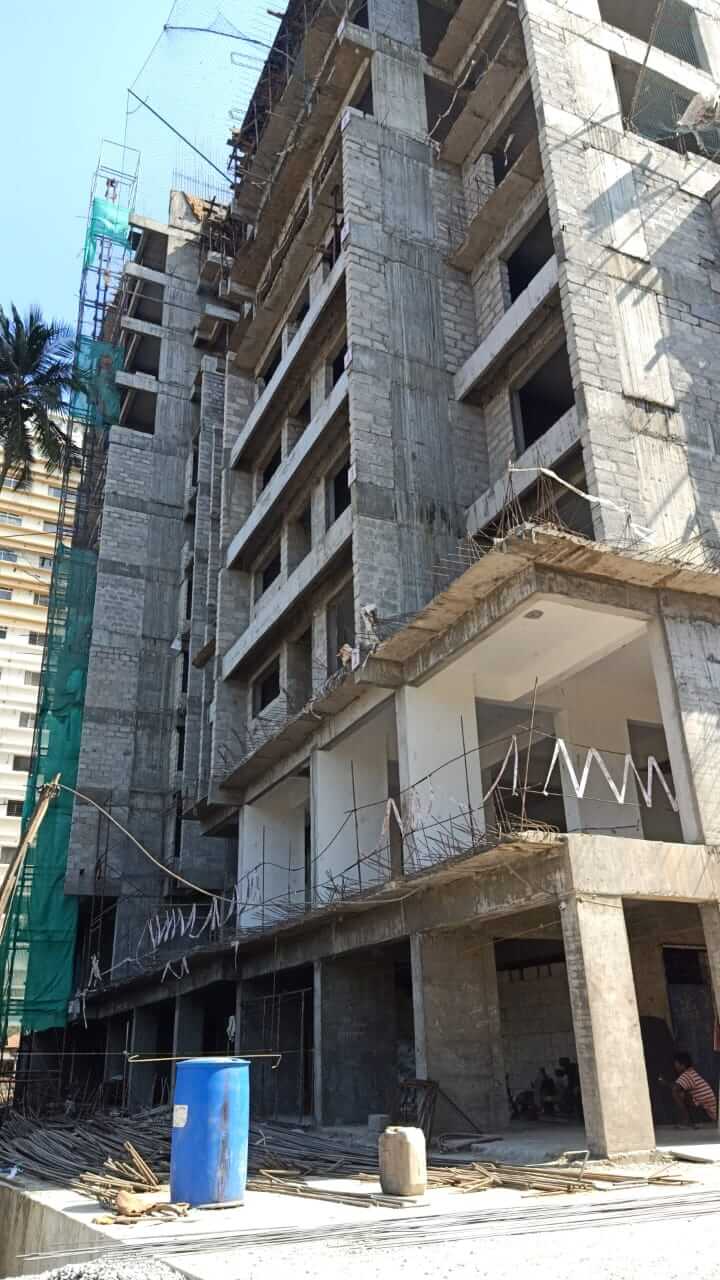

Work status as on 13-04-2022, we have completed the following.
- Structural Works – All Sub-Structural and Structural work 98% Completed.
- Civil Works – Ceiling plastering and wall plastering- Inside flat 100% completed, Masonry – Block/ brick- inside flat area completed, Screeding-35% (till 6th floor completed).
- Internal Finishes – Main door – frame only -100% completed, Waterproofing up to 13 th floor completed, Tiling up to 7th floor inside flat area complete, putty works & inside putty works – 2nd coat putty up to 19th floor inside flat area completed. Handrails-80% completed (main stair – till 11 th floor completed, fire stair – till 13 th floor completed, balcony handrail – till 13th floor completed).
- Electrical, Plumbing & Firefighting works – Concealed plumbing works- up to 13th floor completed.
- External Finishes – External Plastering,-Elevation 2 (95%) & 3 (90%)Completed, Elevation 1- 75% completed.
- Mockup – Completed.
As per the current work status from our site, we are targeted to complete the following works by the end of APRIL 2022.
- Structural Works – Ramp & GF north side driveway 100% to be Completed.
- Civil Works – Screeding- (7th floor 100% to be completed).
- Internal Finishes – Waterproofing-14th floor 100% to be completed. Flooring 8th floor 100% to be completed.
- Electrical, Plumbing & Firefighting works – Concealed plumbing works- 14th – 16th floor to be completed.
- External Finishes – External Plastering,- Elevation-1 80% to be completed (13th – 22nd floor flat E kitchen outside area to be completed)

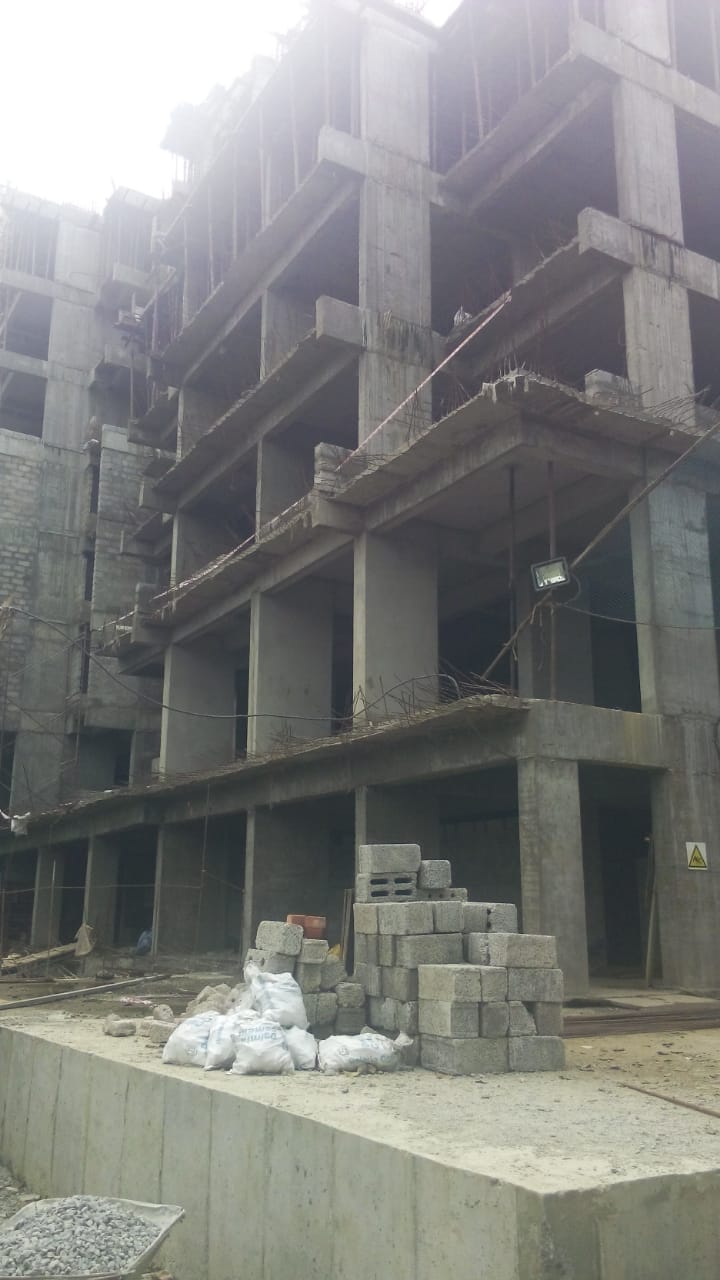

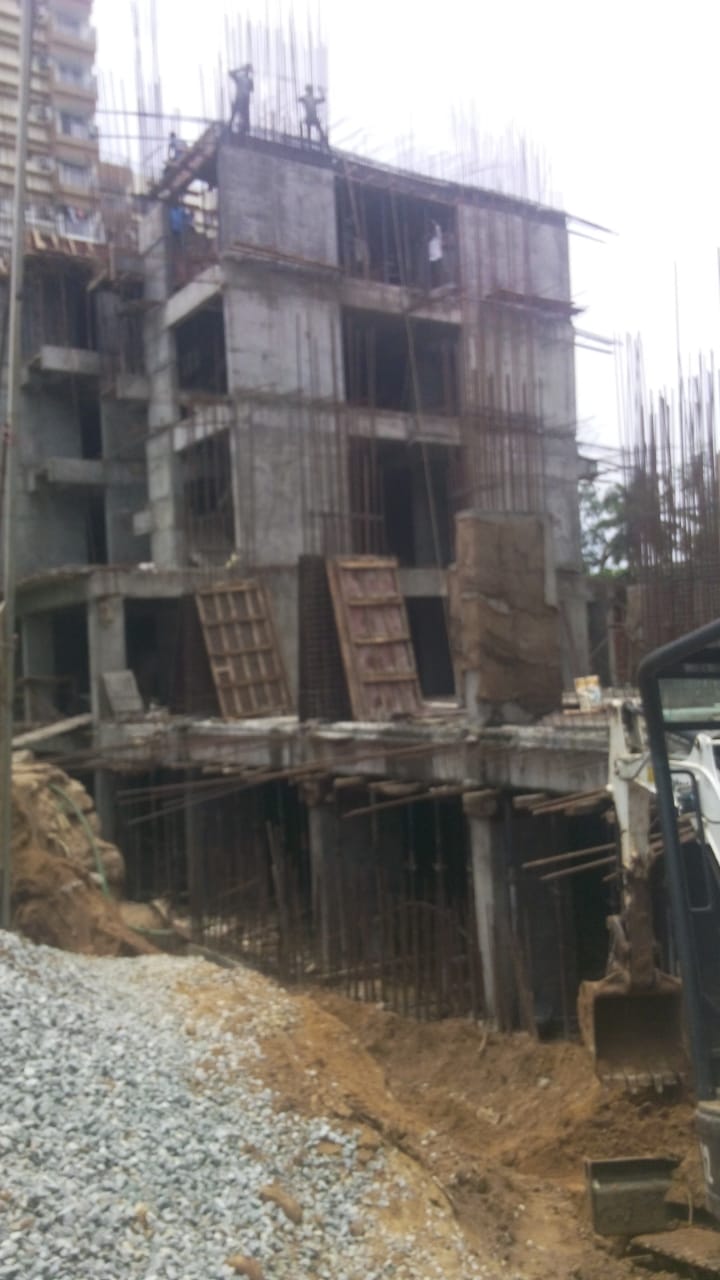

Work status as on 10-03-2022, we have completed the following.
- Structural Works – All Sub-Structural and Structural work 98% Completed.
- Civil Works – Ceiling plastering and wall plastering- Inside flat 100% completed, Masonry – Block/ brick- inside flat area completed, Screeding-30% completed.
- Internal Finishes – Main door – frame only -100% completed, Waterproofing up to 13 th floor completed,Tiling up to 6th floor inside flat area complete. putty works & inside putty works up to-13th floor inside flat area completed. Handrails-80% completed.
- Electrical, Plumbing & Firefighting works – Concealed plumbing works-13th floor completed.
- External Finishes – External Plastering,-Elevation 2&3 Completed.Elevation 1- 50% completed.
- Mockup – Completed.
As per the current work status from our site, we are targeted to complete the following works by the end of MARCH 2022.
- Structural Works – Ramp & GF north side drive way 100% to be Completed.
- Civil Works – Screeding-35% to be completed.
- Internal Finishes – Waterproofing-14th floor to be completed. Flooring 7th floor to be completed.Putty work-14th floor to be completed.
- Electrical, Plumbing & Firefighting works – Concealed plumbing works-14th floor to be completed.
- External Finishes – External Plastering,-Elevation-1 80% to be completed

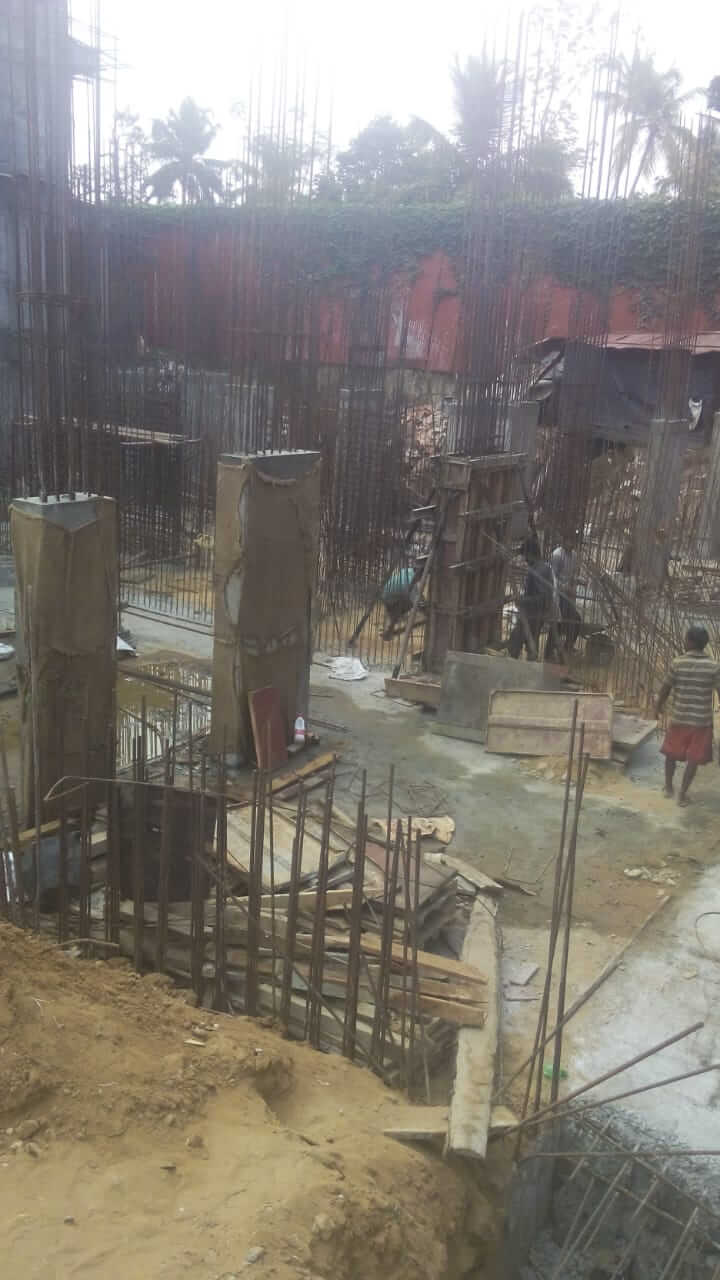

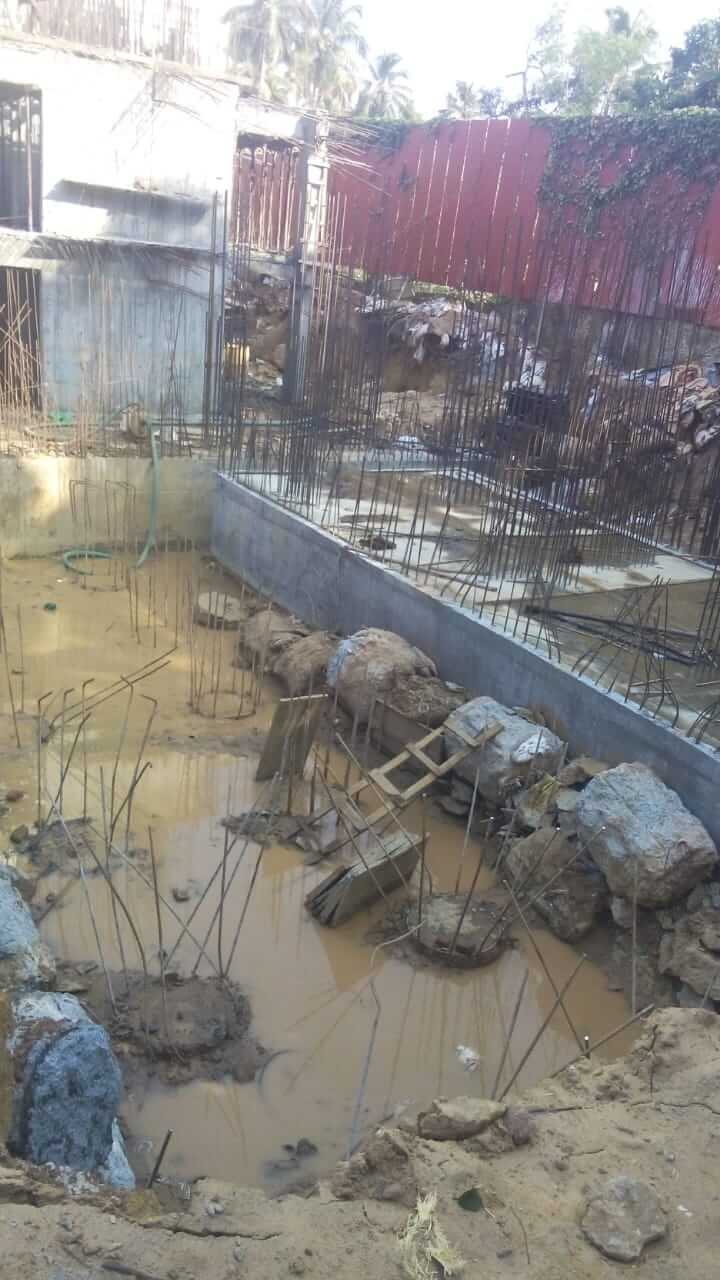

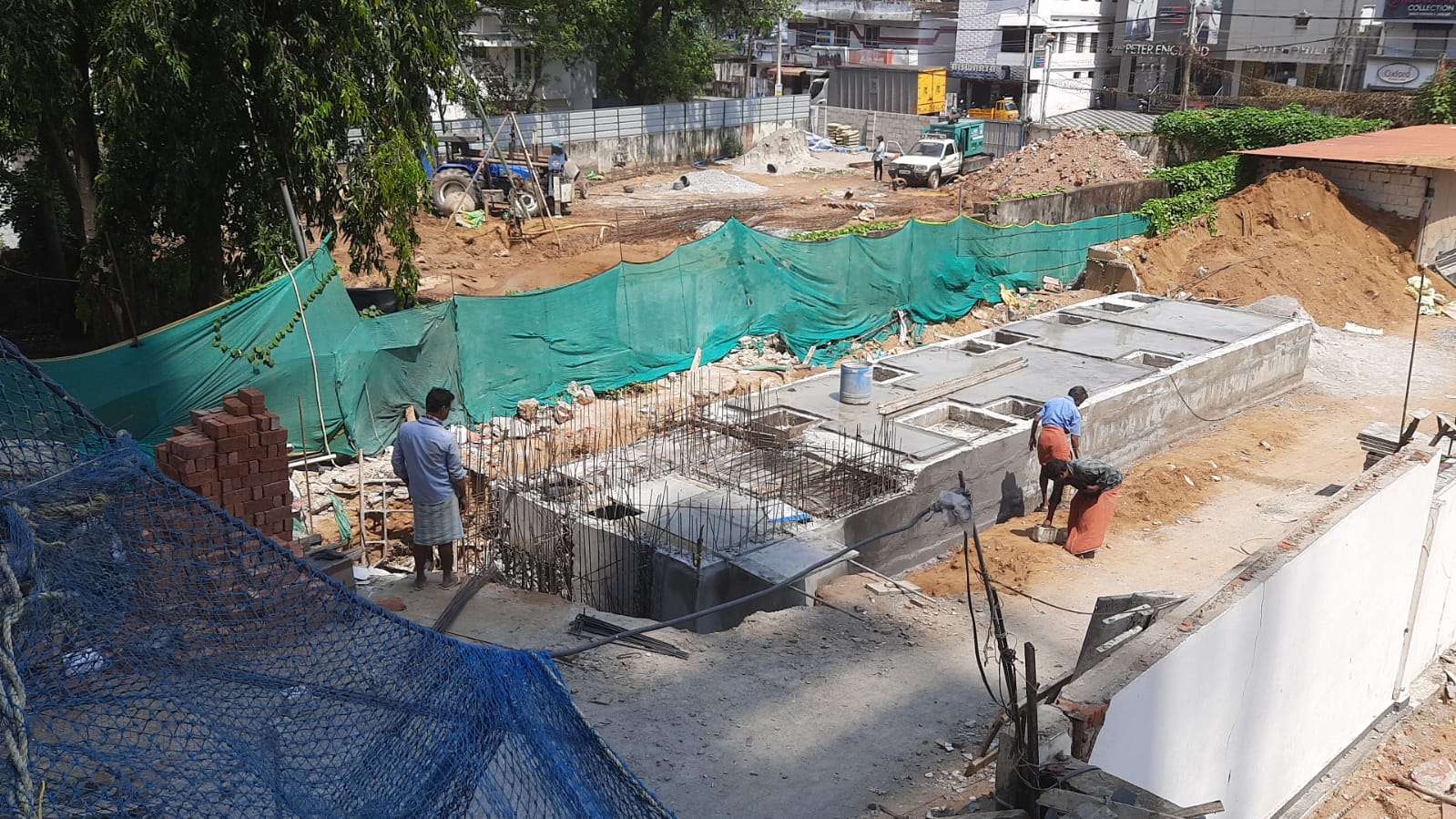

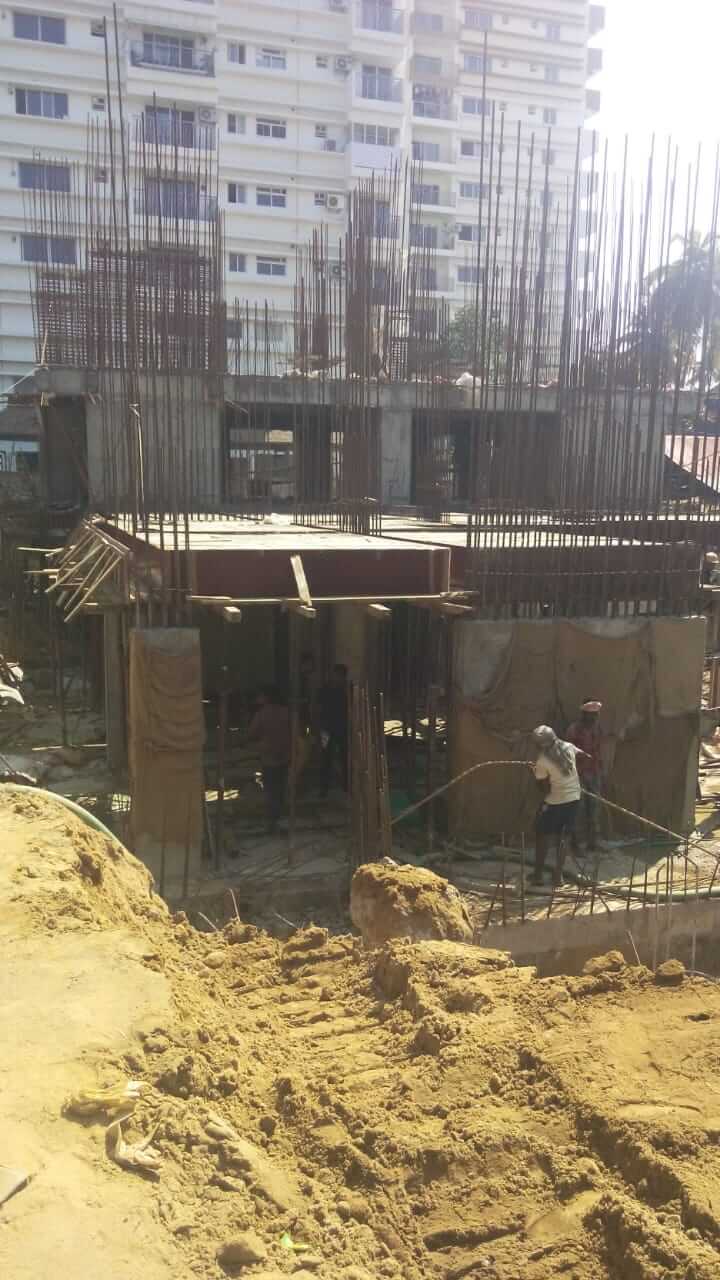

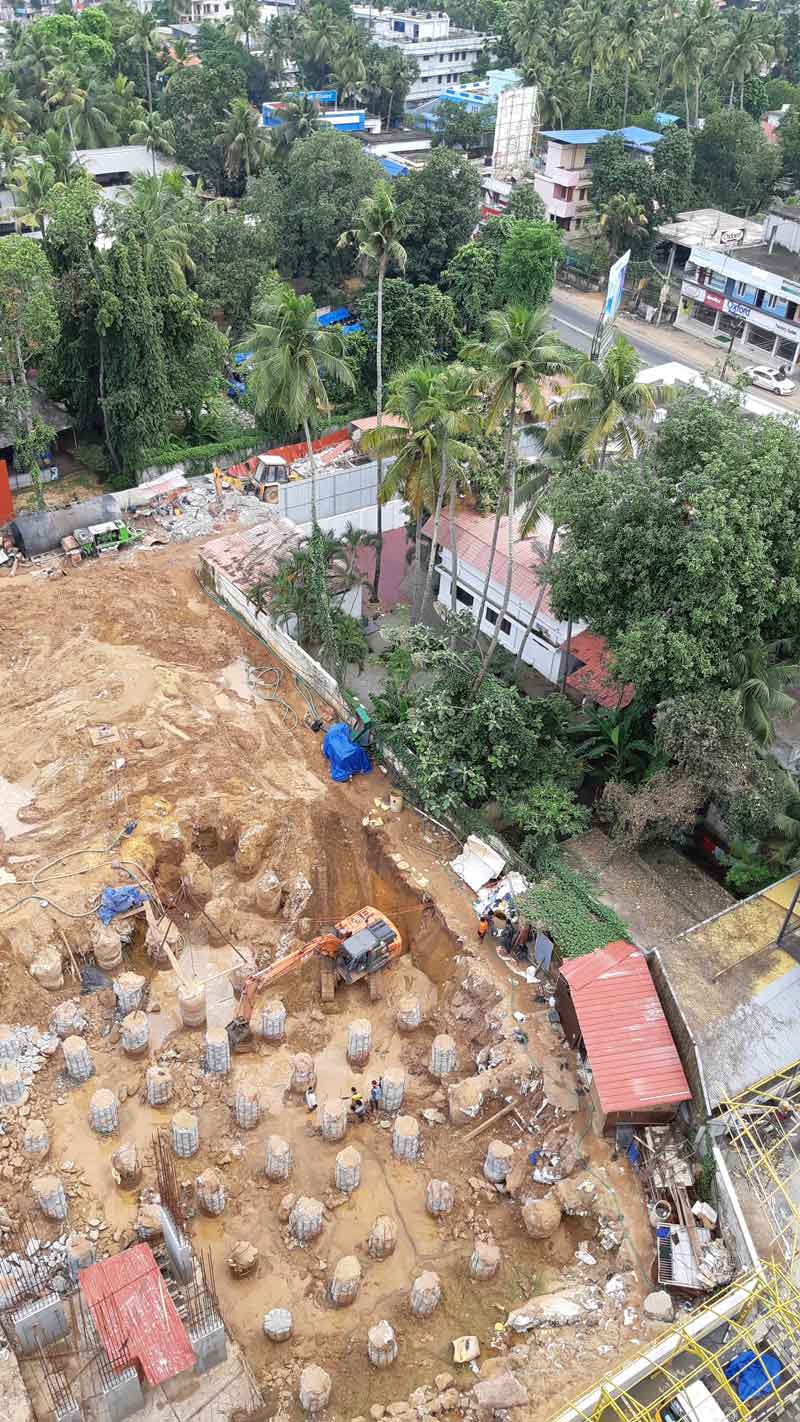

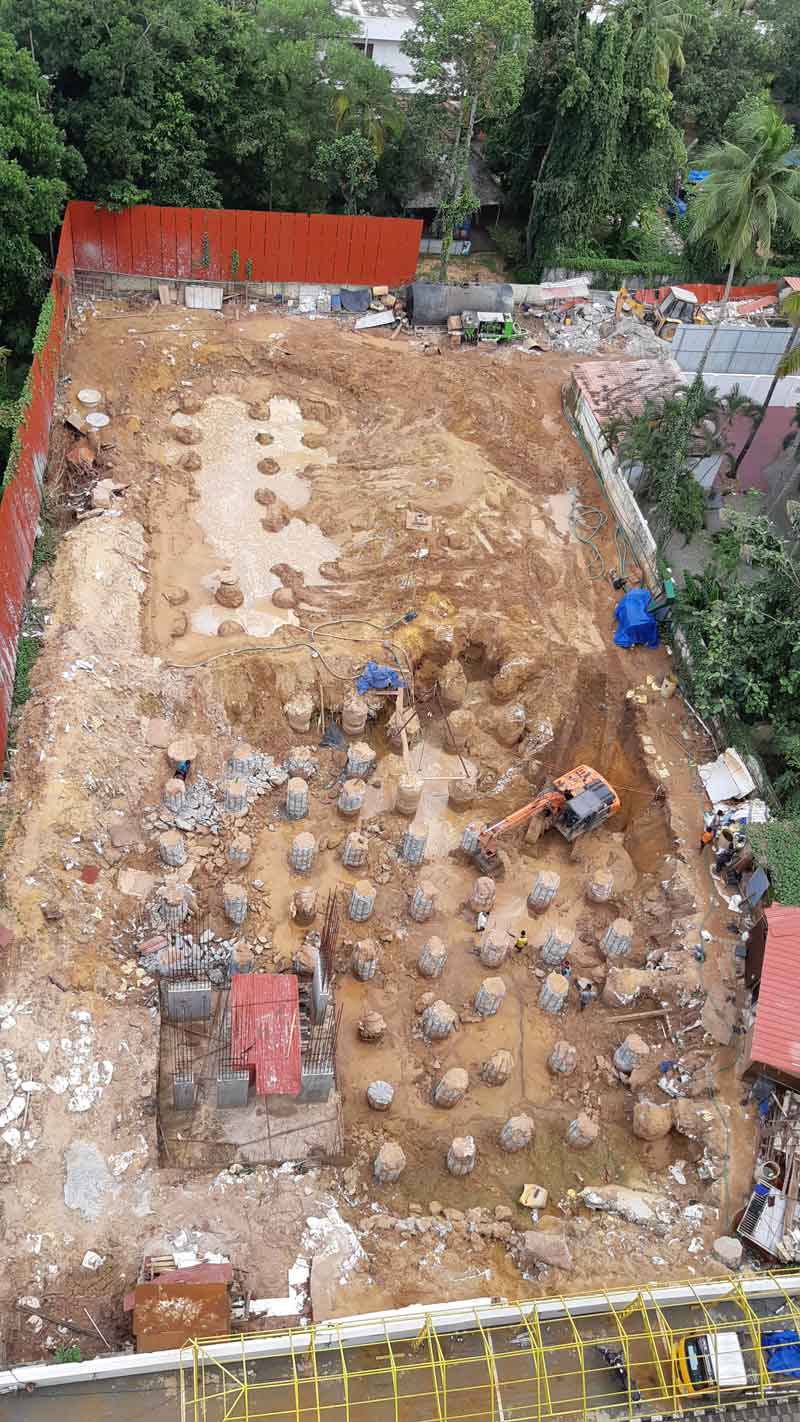

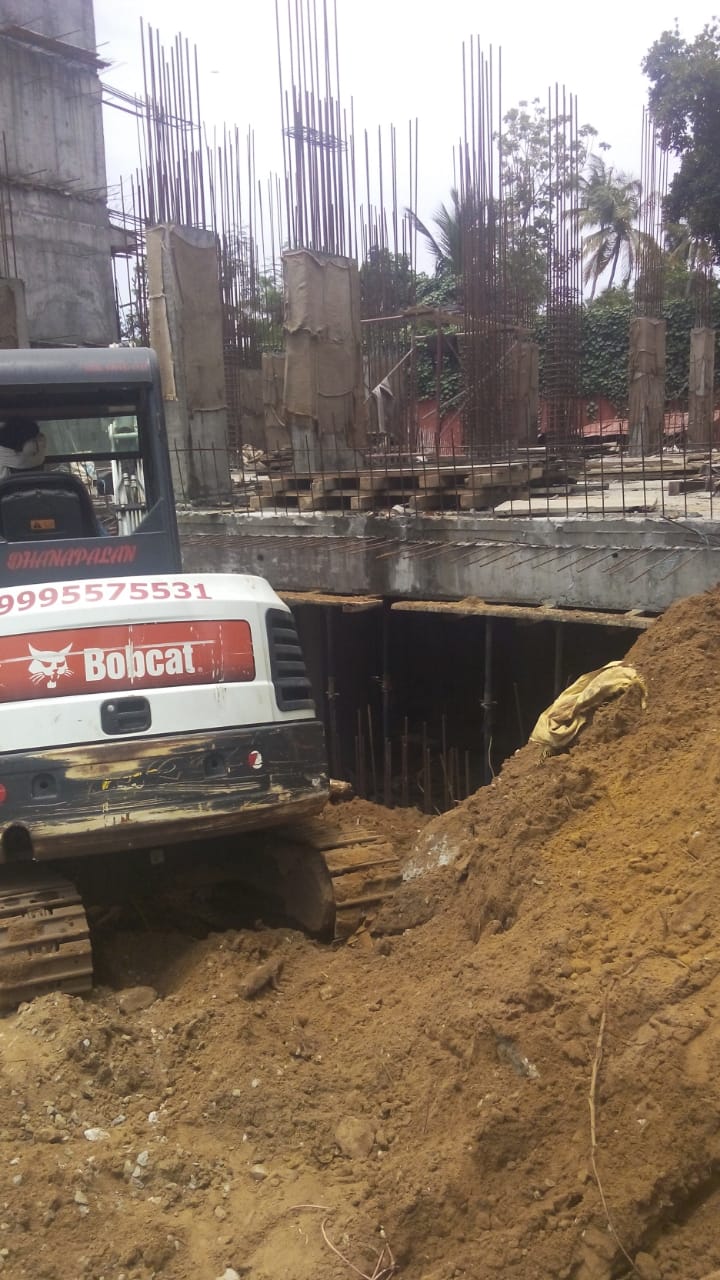

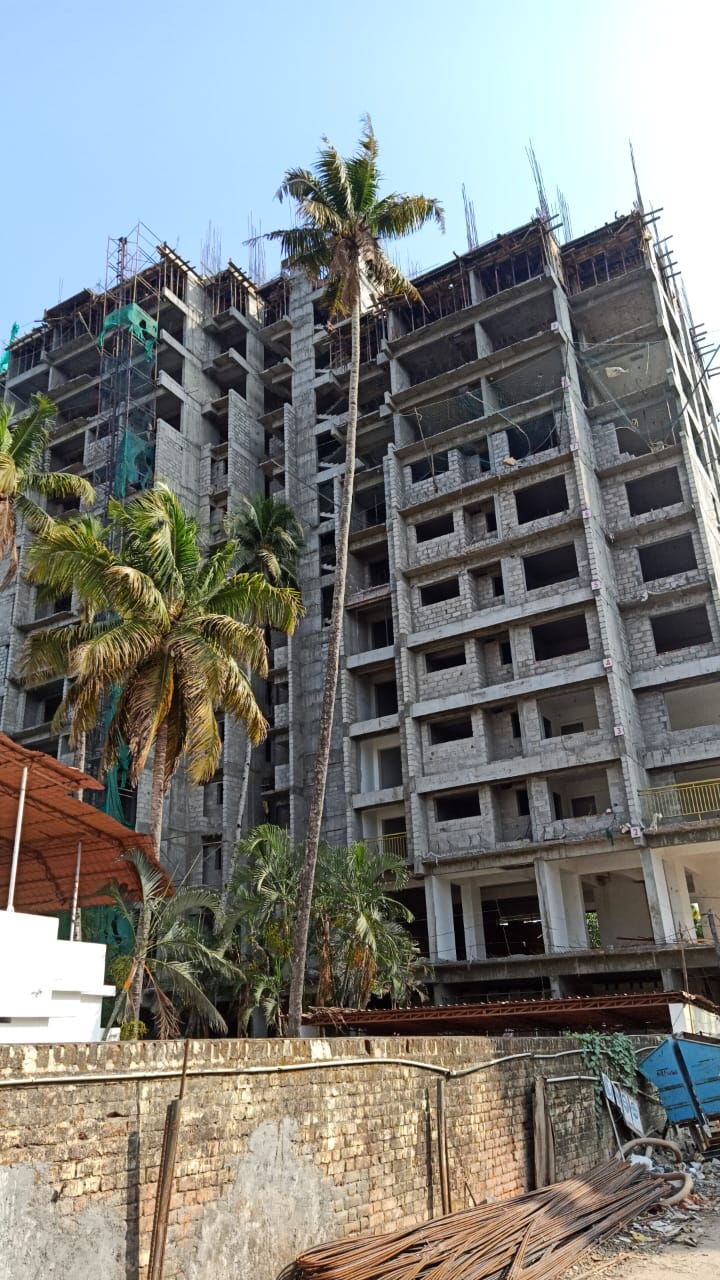

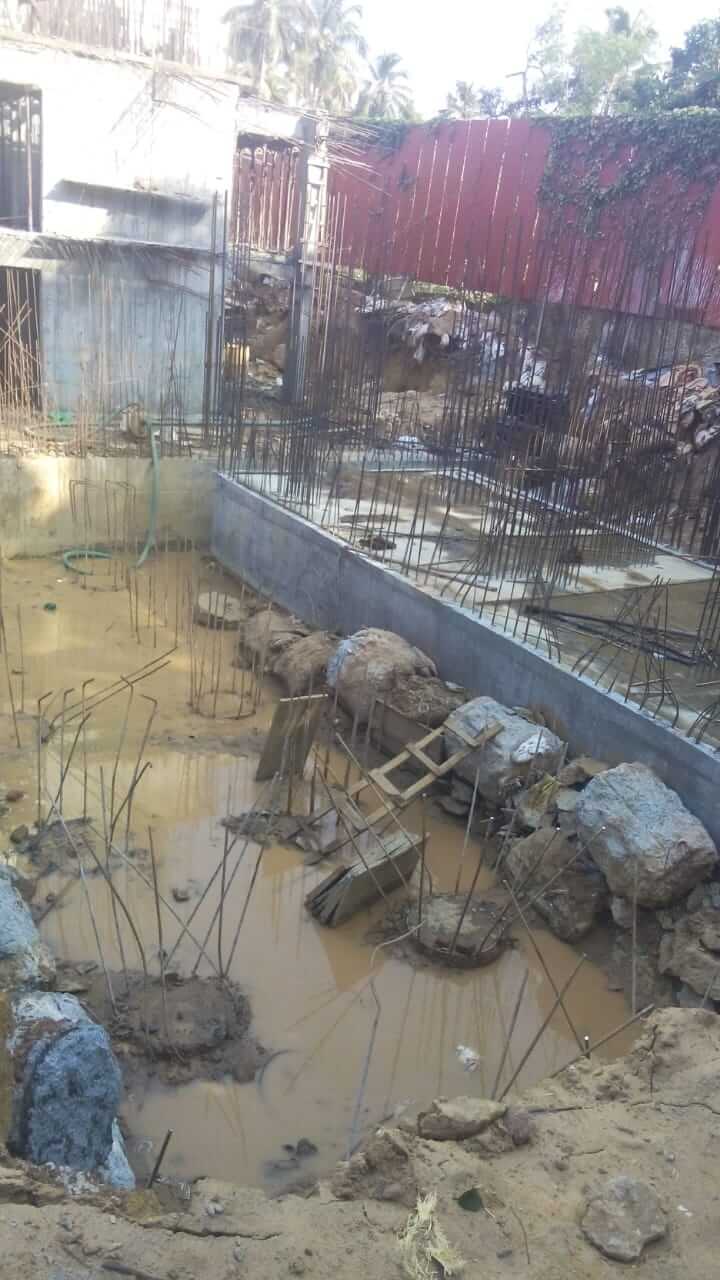

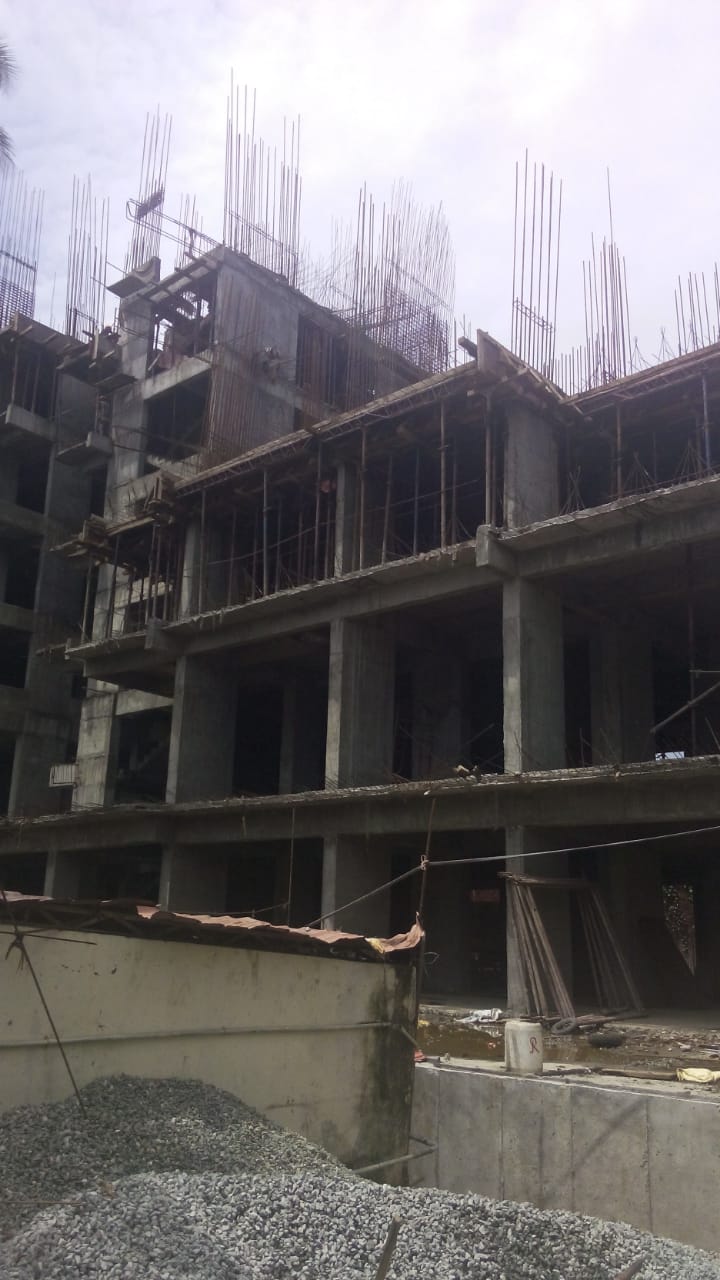

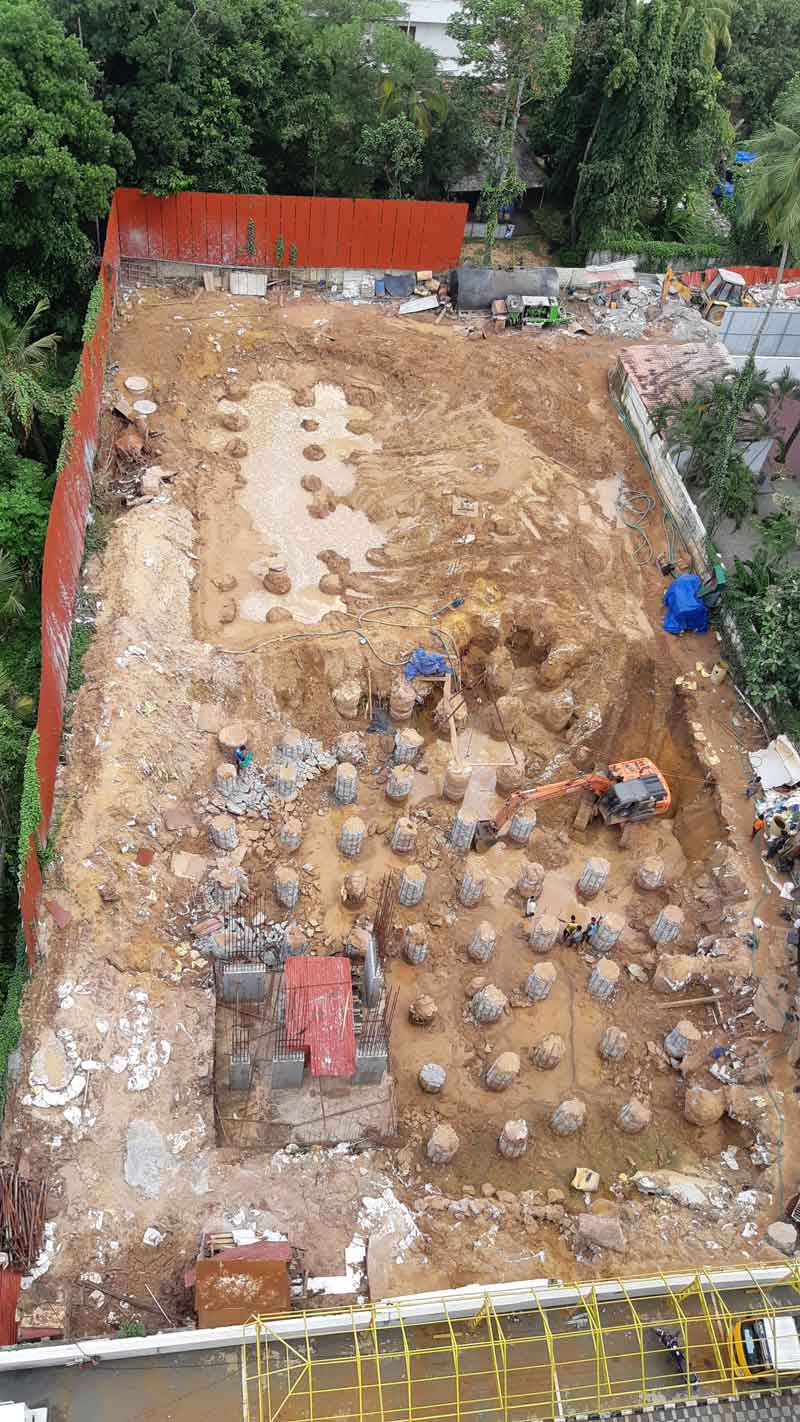

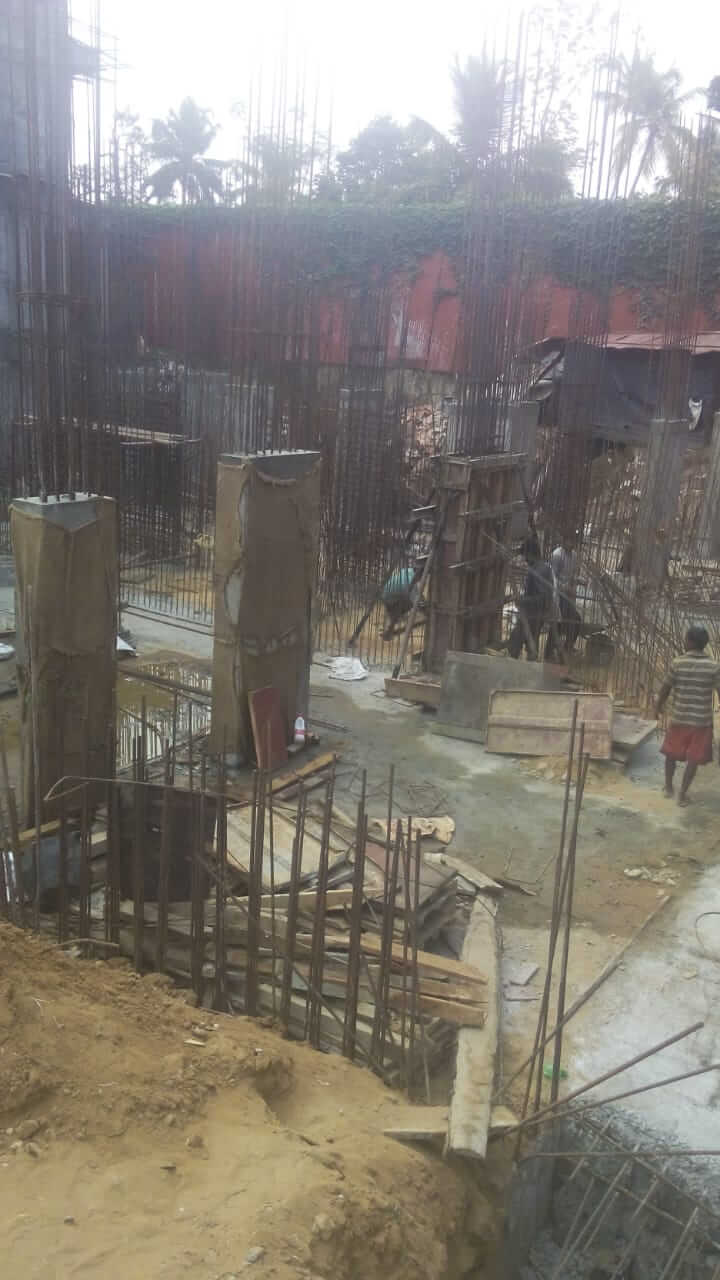

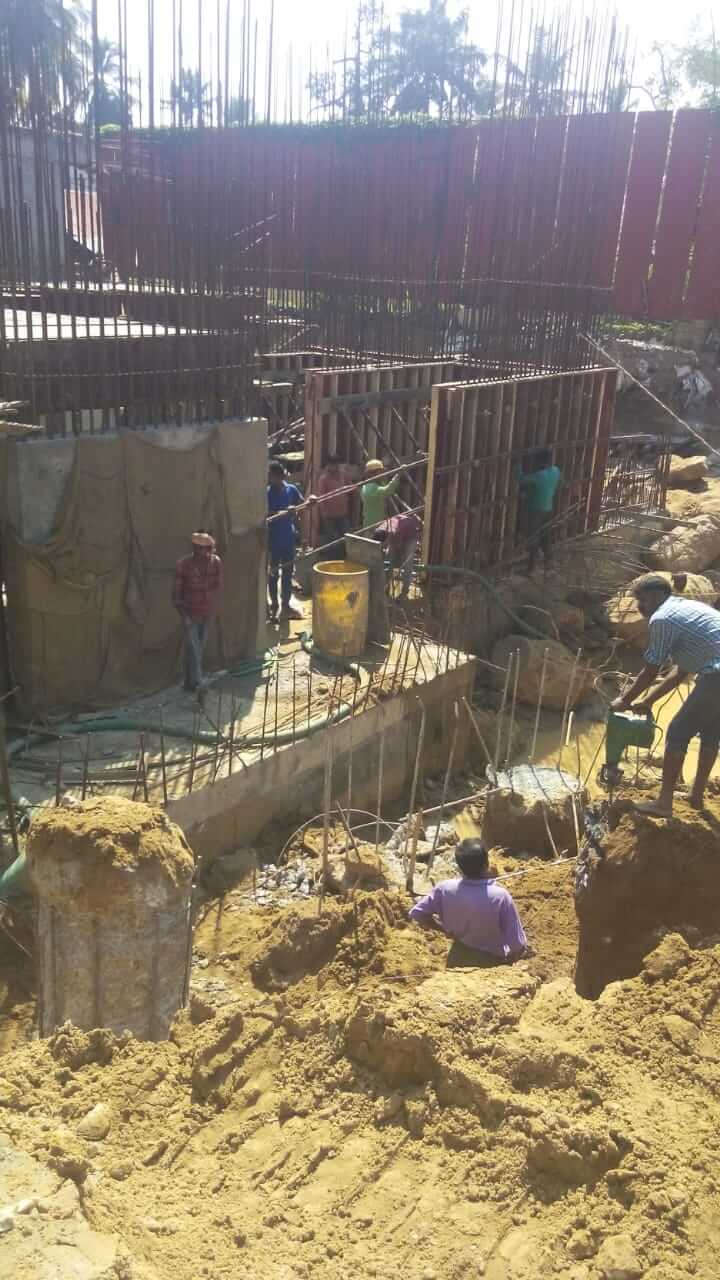

Work status as on 09-04-2021, we have completed the following.

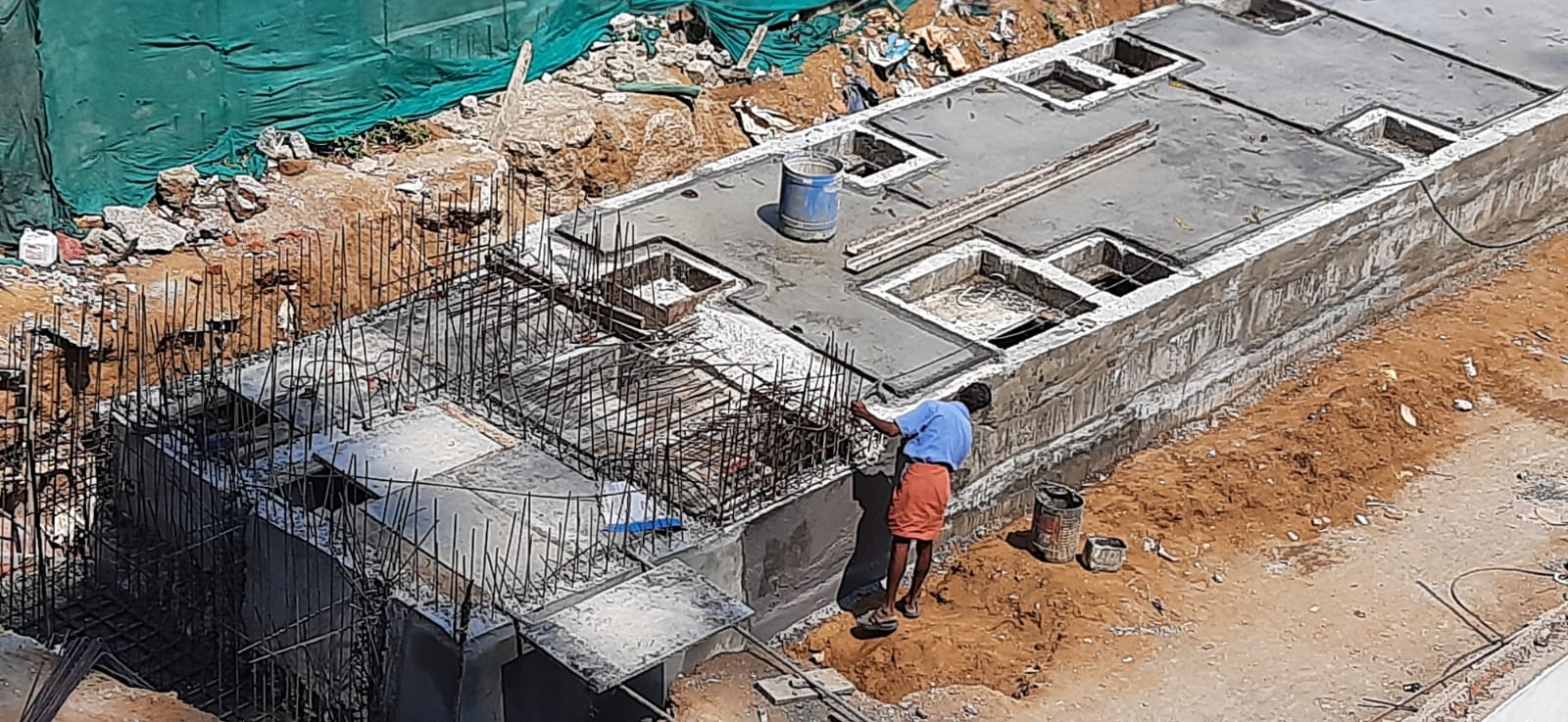

- Raft slab-S-E-corner side 100% completed.

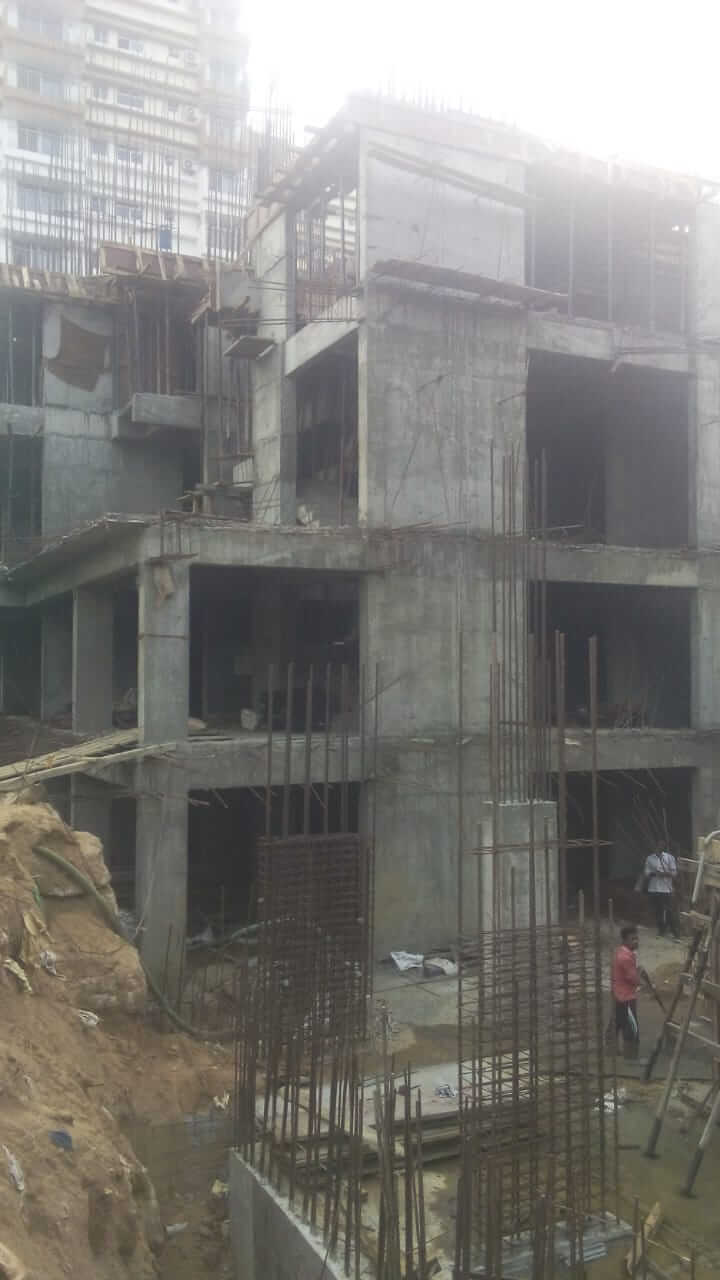

- SLAB RCC:
- BF Slab RCC Work-98% completed
- Slab RCC work GF-95% completed, 1st -18th floor -100% completed, 20th floor:-60% completed,19th floor,21st floor(aminety) -50% completed.

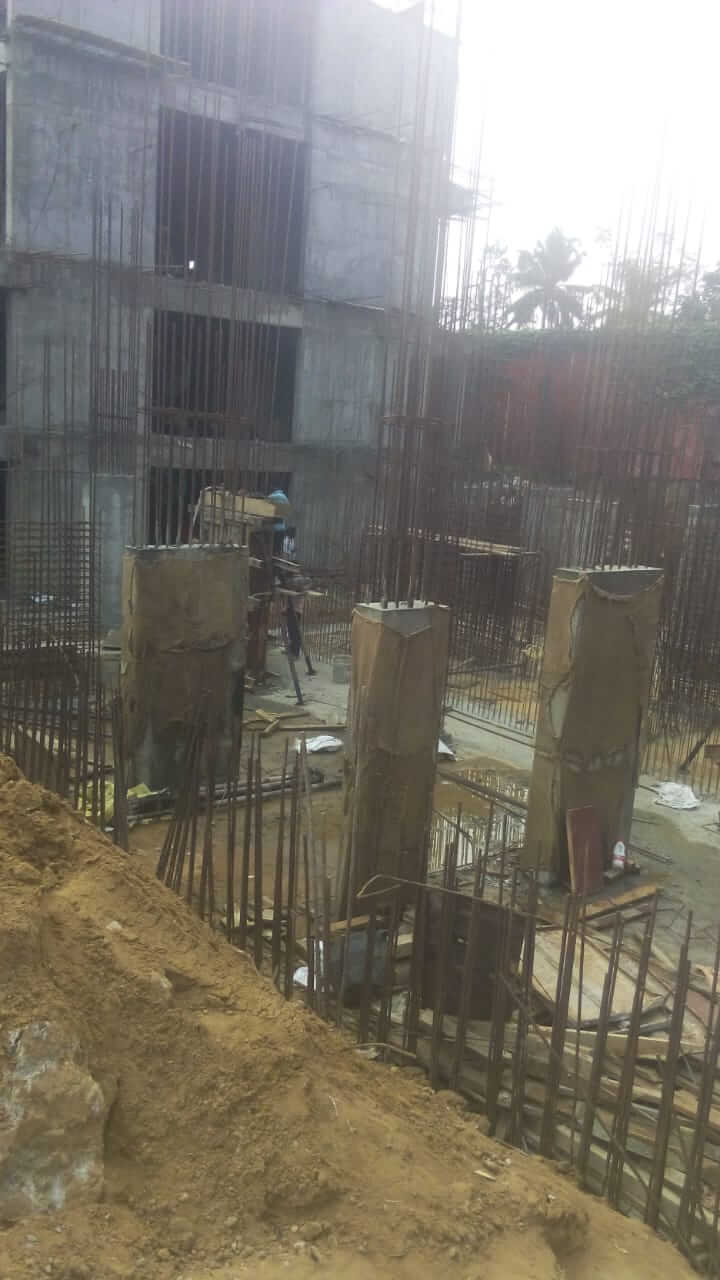

- Column RCC Work :
- 14th floor-19th floor-100% completed.
- 20th floor -60% completed

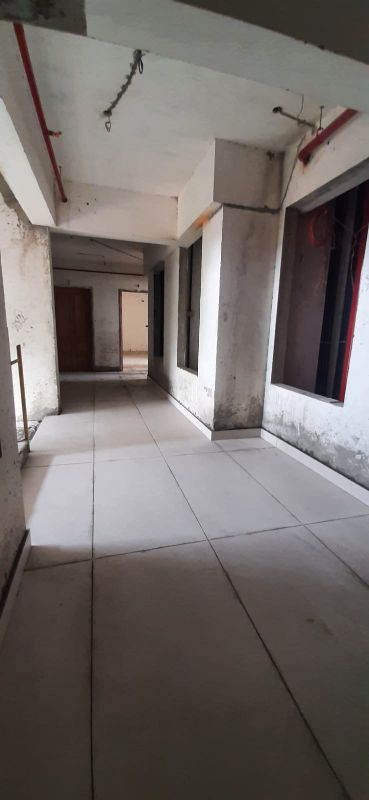

- Ceiling plastering
- 1st -17th floor -100% completed.
- 18th -20th floor -50% completed
- Block Masonry
- upto 17th floor -100% completed
- 18th-19th floor -50 % completed
- Wall chasing
- upto 15th floor :100% completed
- 16th -19th floor:- 40% completed
- BALCONY HANDRAIL WORK
- upto 15th floor – 100% completed.
- STAIRCASE HANDRAIL WORK
- 2nd floor -9th floor main and fire -100% completed.

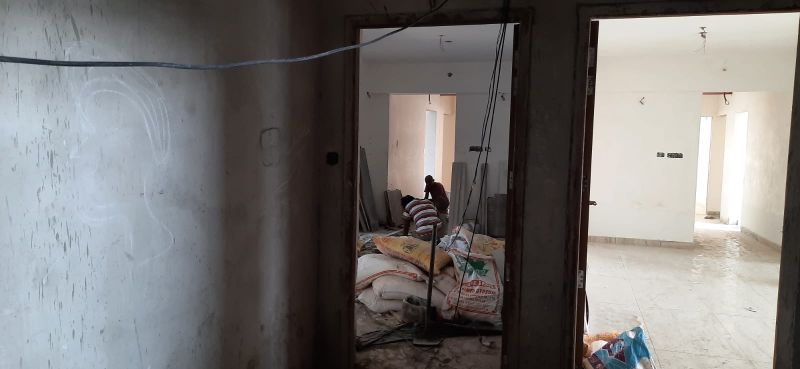

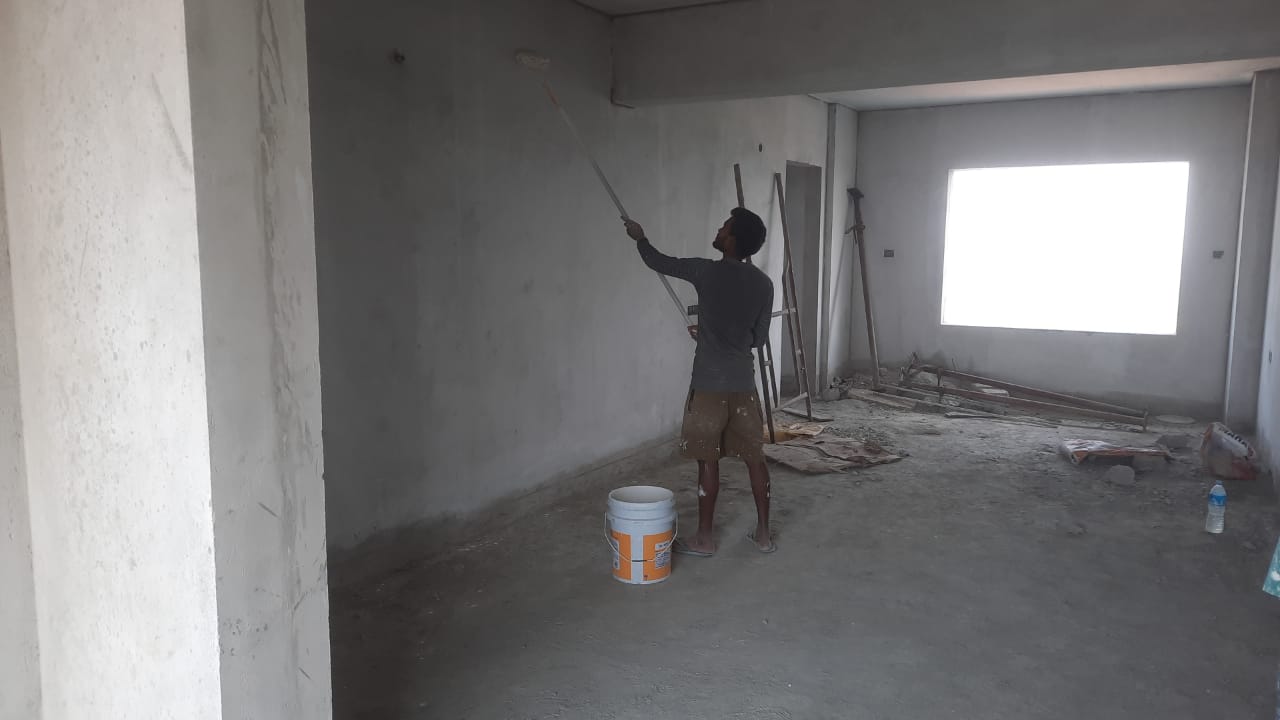

- Internal Wall Plastering
- upto 14th floor -100% completed.

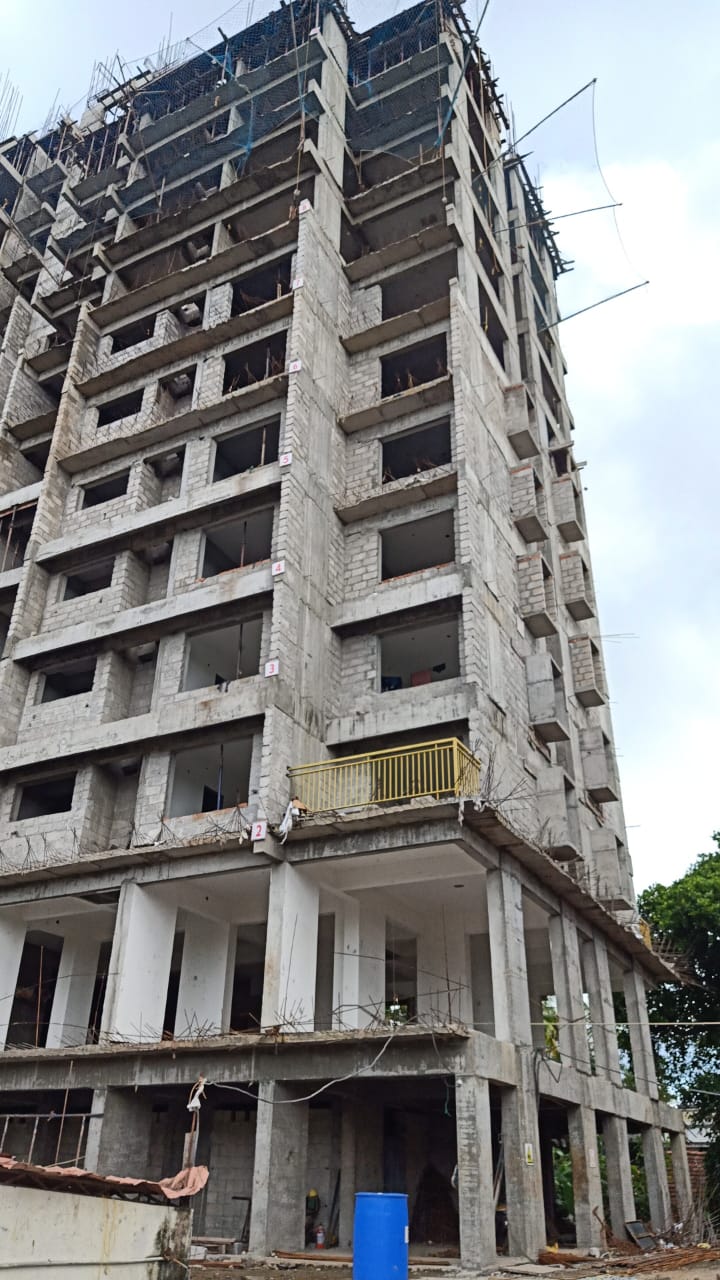

- External Wall Plastering
- 1st -13th floor elevation1, east side-80% completed
- 1st -13th floor elevation2, north side-30% completed
- FIRST COAT PUTTY (INSIDE )
- upto 12th floor:-100 % Completed.
- WATERPROOFING
- upto 8th floor toilet -100% completed
- 3th floor balcony -100% completed
- PLUMBING WORK
- upto 12th-100% Completed
- Piping work
- upto 6th floor-100% completed/li>
- ELECTRICAL WIRE PULLING
- 2nd floor-100% completed

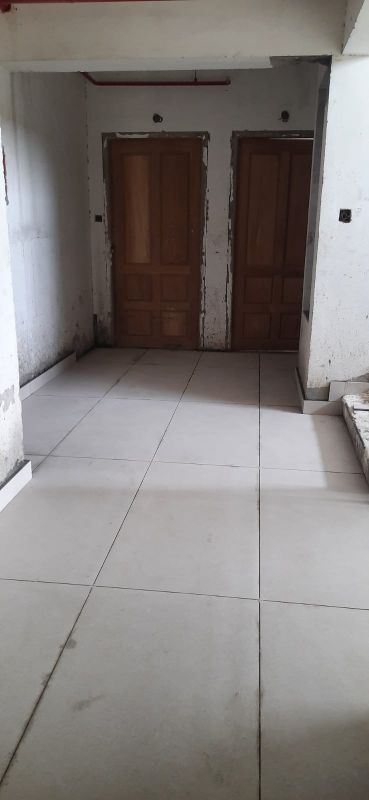

- WALL TILING TOILET
- 2nd floor (A)-100% completed.
- FABRICATION WORK
- Window grill (2A)-100% completed
- MOCK-UP FLAT (2A)
- 2A: Putty work 100% completed
- Balcony Handrail work: completed
- fire piping (2A)-100% completed
- electrical wiring-100% completed
- duct door 2nd floor -100% completed.
- Plumbing( toilet) -100% completed
- Waterproofing:- 100% completed.
- floor tile work (2A)-100% completed.
As per the current work status from our site, we are targeted to complete the following works by the end of APRIL 2021.
- SLAB RCC:
- BF Slab RCC Work-100% completed
- SLAB RCC work: 19th,20th :-100% to be completed, 21st floor(aminety) -60% to be completed.
- Column RCC Work :
- 20th floor-100% to be completed.
- 21st floor -60% to be completed
- Ceiling plastering
- 18th -20th floor-100% to be completed.
- Block Masonry
- 18th floor -100% to be completed
- Wall chasing
- 16th floor:-100% to be completed
- BALCONY HANDRAIL WORK
- 16th floor 100% to be completed
- STAIRCASE HANDRAIL WORK
- 10th-12th floor main and fire -100% to be completed.
- Internal Wall Plastering
- 15th floor-100% to be completed.
- External Wall Plastering
- 1st -13th floor elevation1,east side-100% to be completed
- 1st -13th floor elevation2, north side-50% to be completed

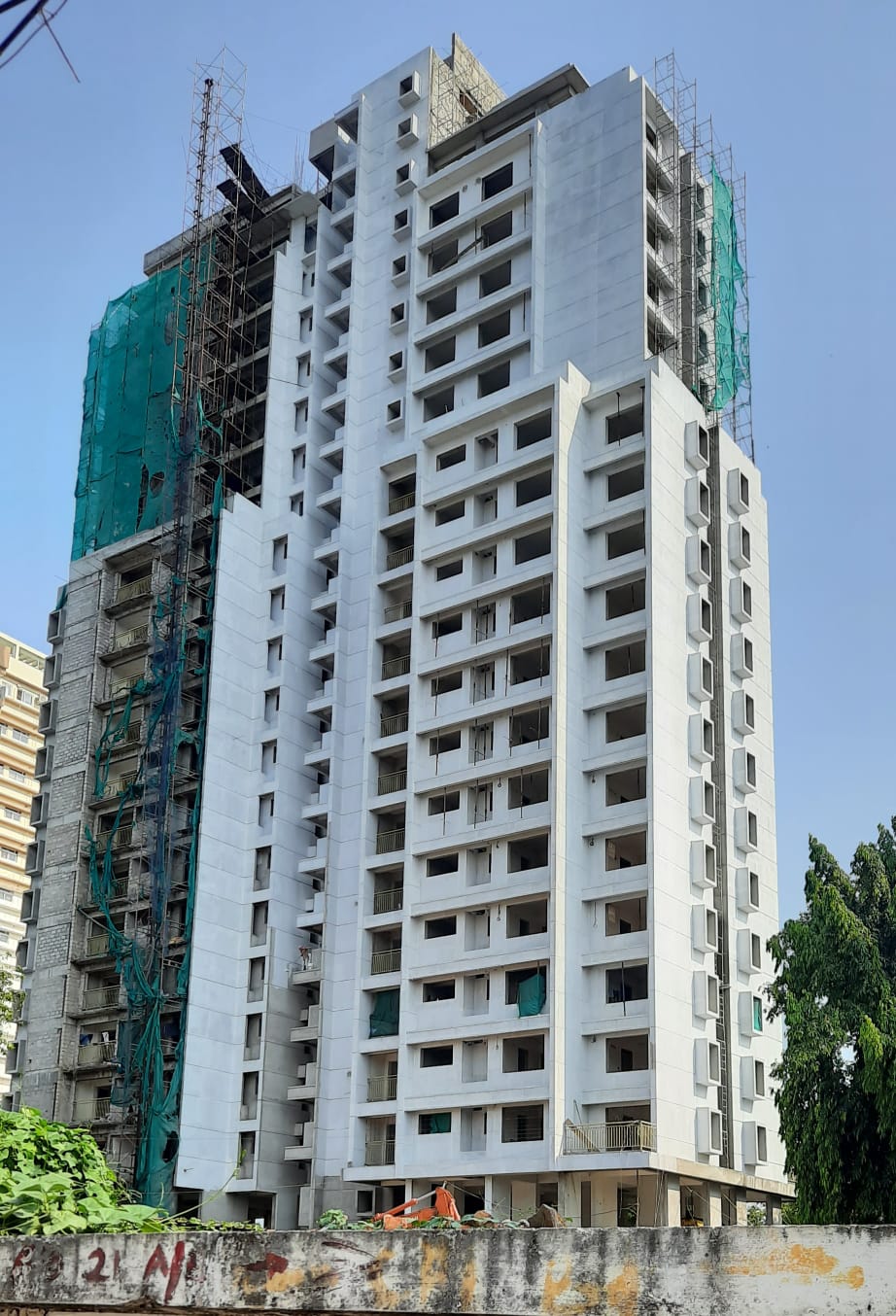

- 1st -13th floor elevation3, west side-30% to be completed
- FIRST COAT PUTTY (INSIDE )

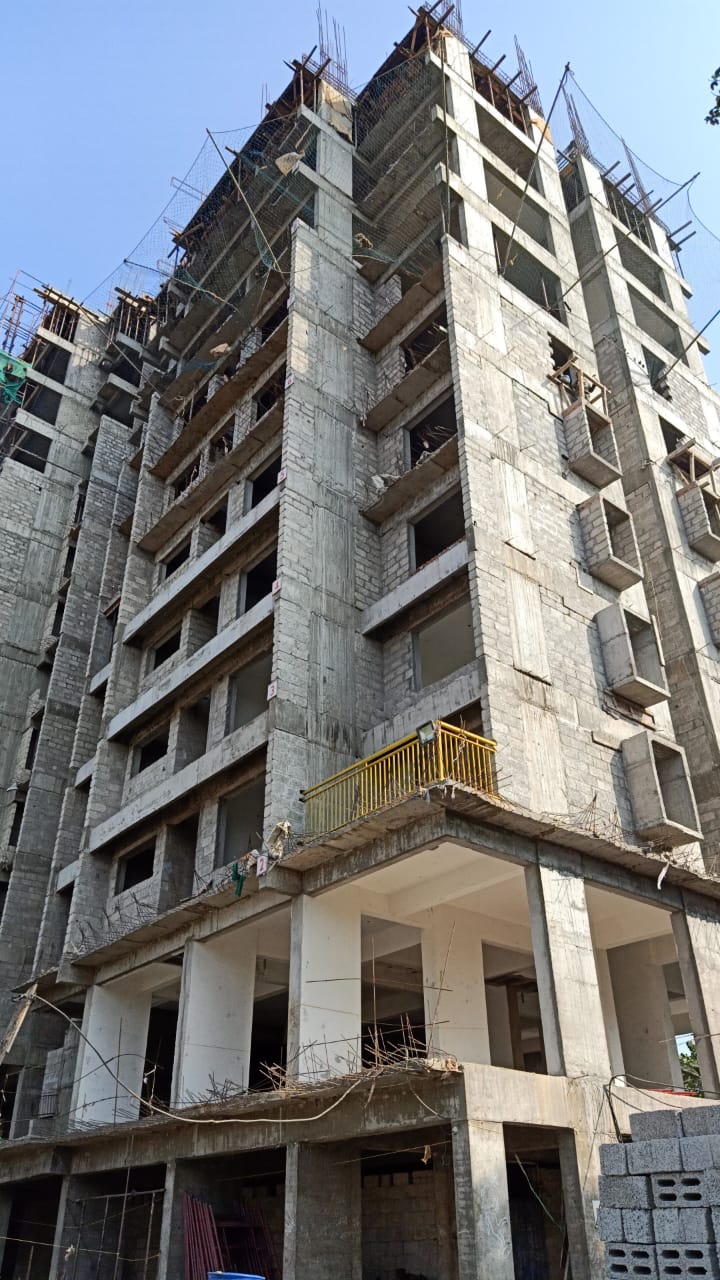

- 13th floor – 100% to be completed.

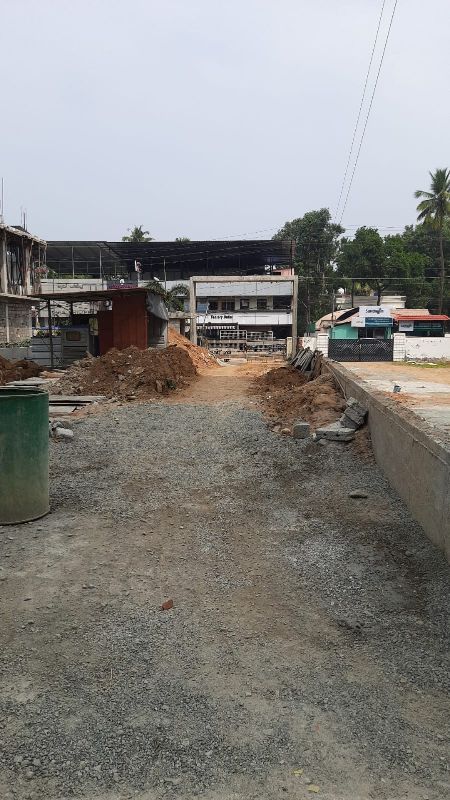

- RAMP WORK
- 60% to be completed.
- WATERPROOFING
- 9th-floor toilet -100% to be completed
- 4th-floor balcony -100% to be completed
- PLUMBING WORK
- 13th-100% to be Completed
- 7th floor-100% to be completed.
- ELECTRICAL WIRE PULLING
- 3rd floor-100% to be completed
- WALL TILING TOILET
- 2nd floor-100% to be completed.
- MOCK-UP FLAT (2A)
- fire piping (2BC)-100% to be completed

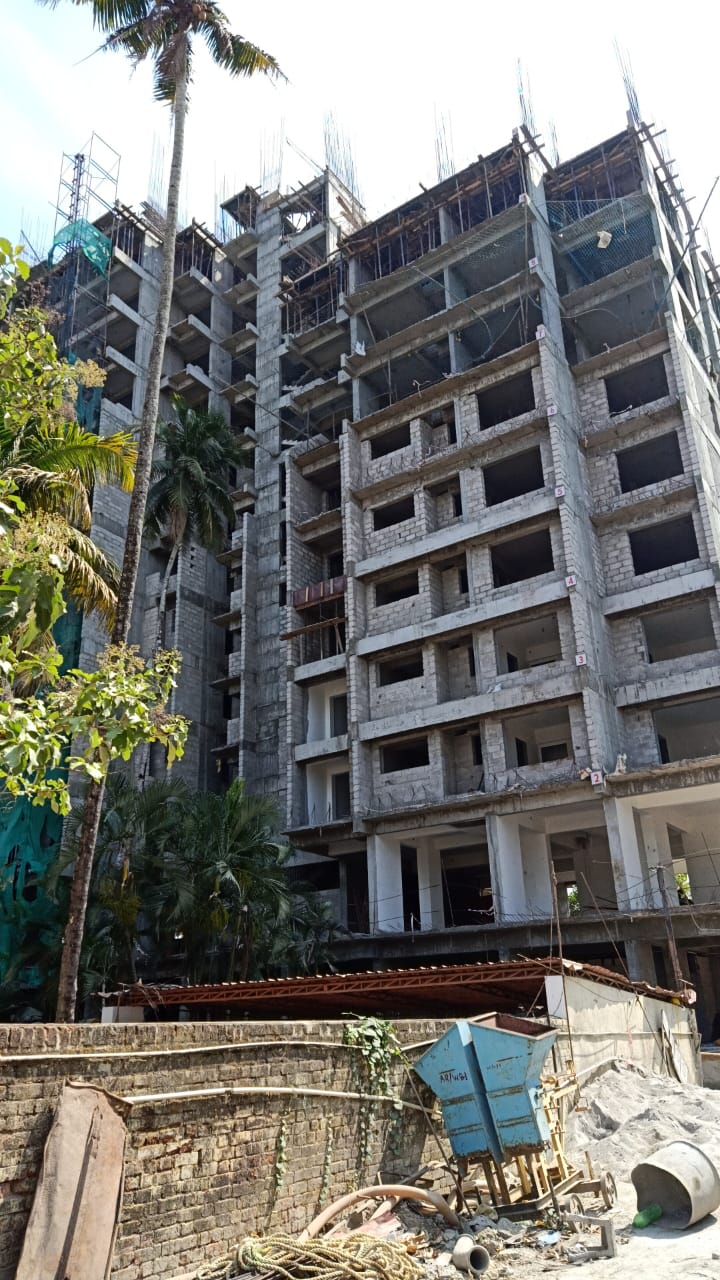

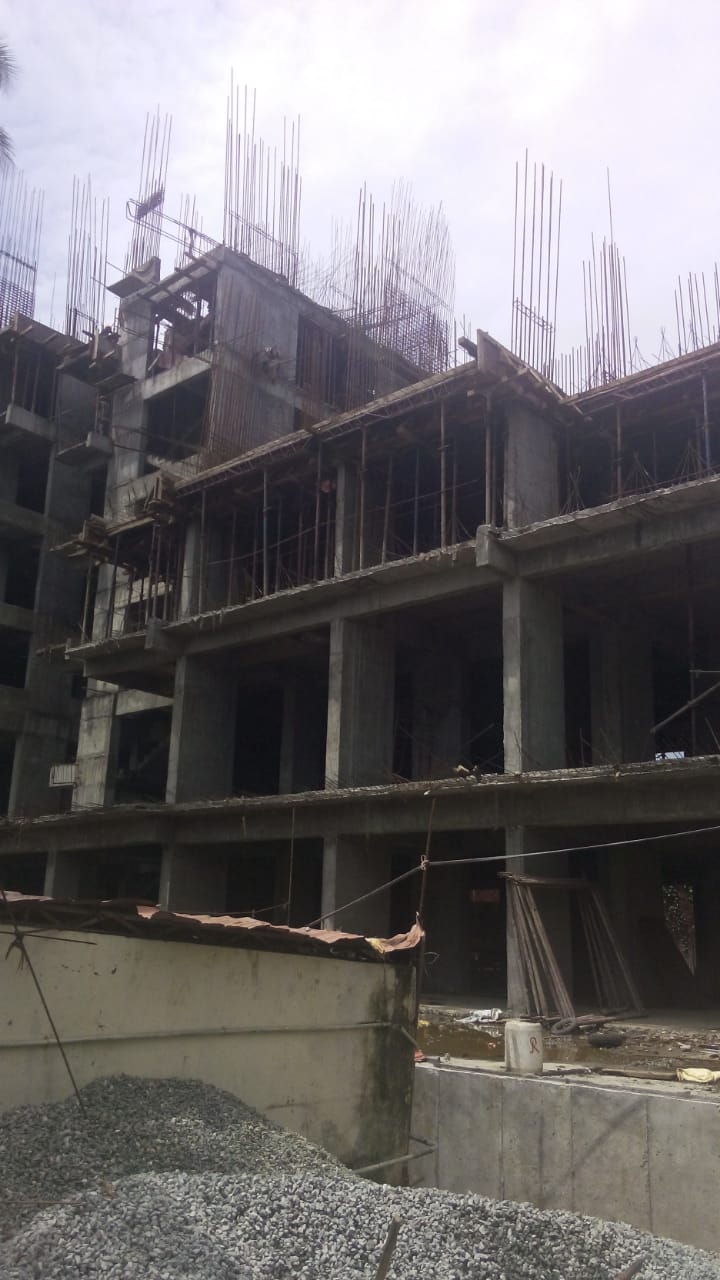

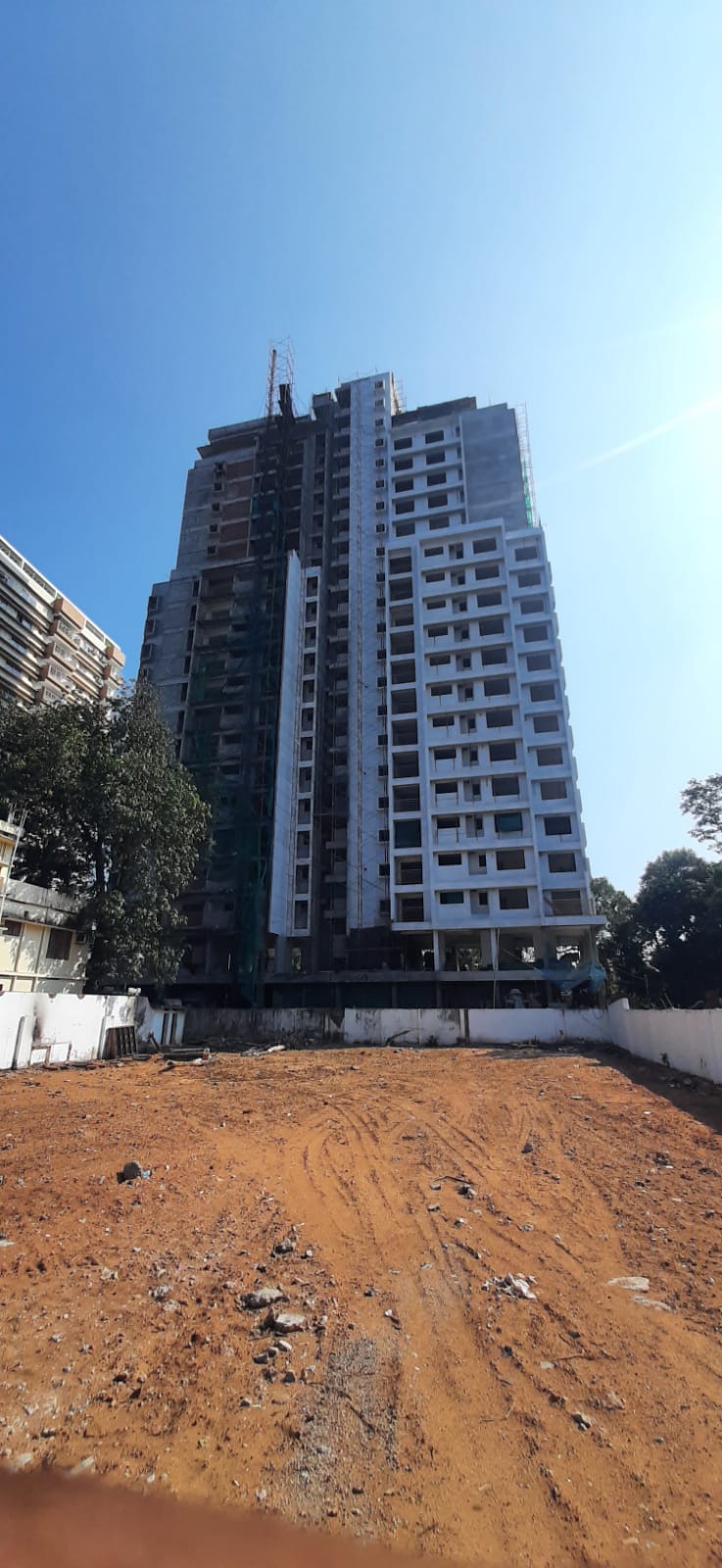

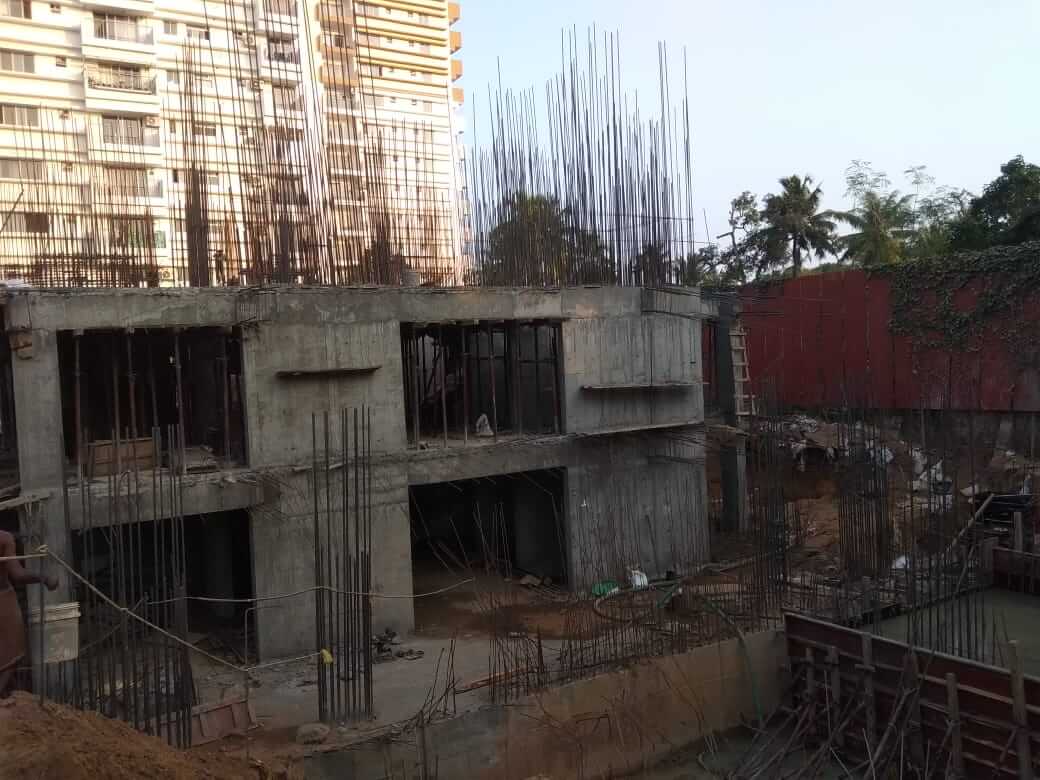

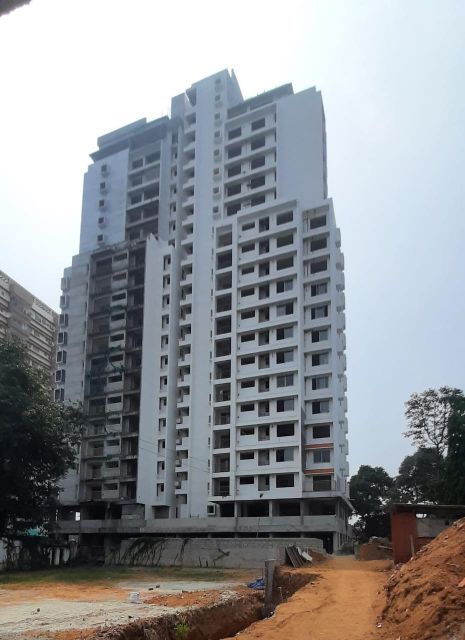

Work status as on 11-03-2021, we have completed the following.
- Raft slab-S-E-corner side 100% completed.
- SLAB RCC:
- BF Slab RCC Work-98% completed
- Slab RCC work GF ,FF-95% completed, 2nd -16th floor -100% completed, 17th ,20th floor:-60% completed,21st floor(aminety) -25% completed.
- Column RCC Work :
- 14th floor-18th floor-100% completed.
- 19 floor-20th floor -60% completed
- Ceiling plastering:
- 1st -15th floor -100% completed.
- 16th -20th floor -50% completed
- Block Masonry:
- upto 16th floor -100% completed
- 17th-19th floor -50 % completed
- Wall chasing: upto 14th floor :100% completed, upto 14th floor :100% completed

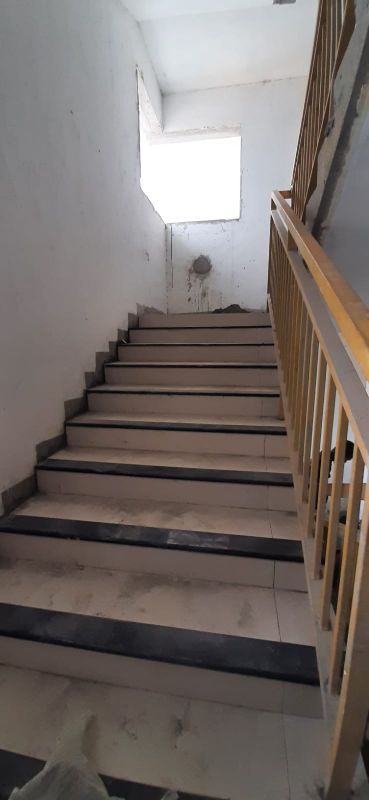

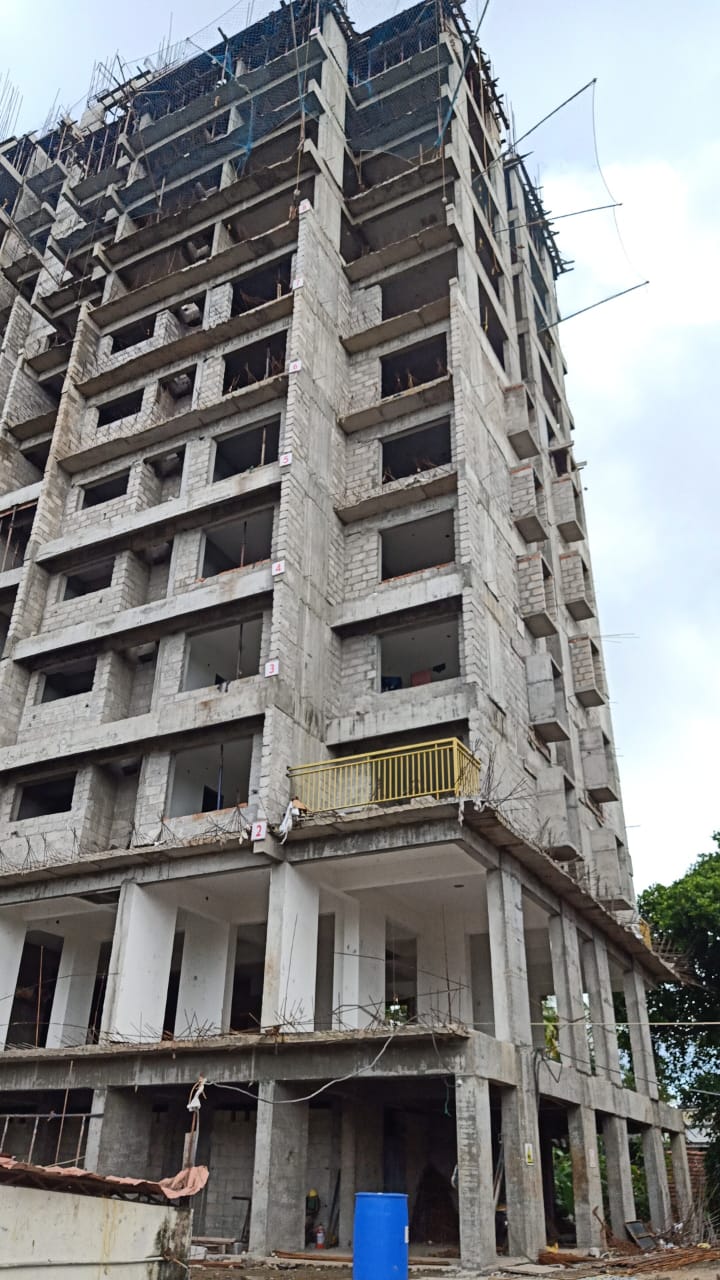

- BALCONY HANDRAIL WORK: upto 13th floor – 100% completed.
- STAIRCASE HANDRAIL WORK: 2nd floor -9th floor main and fire -100% completed.
- Internal Wall Plastering: up to 12th floor -100% completed.
- External Wall Plastering:
- 1st -13th floor elevation1, east side-60% completed
- 1st -13th floor elevation2, north side-20% completed

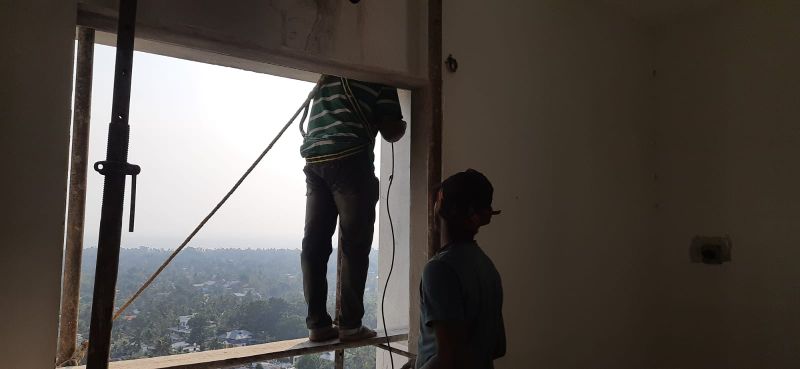

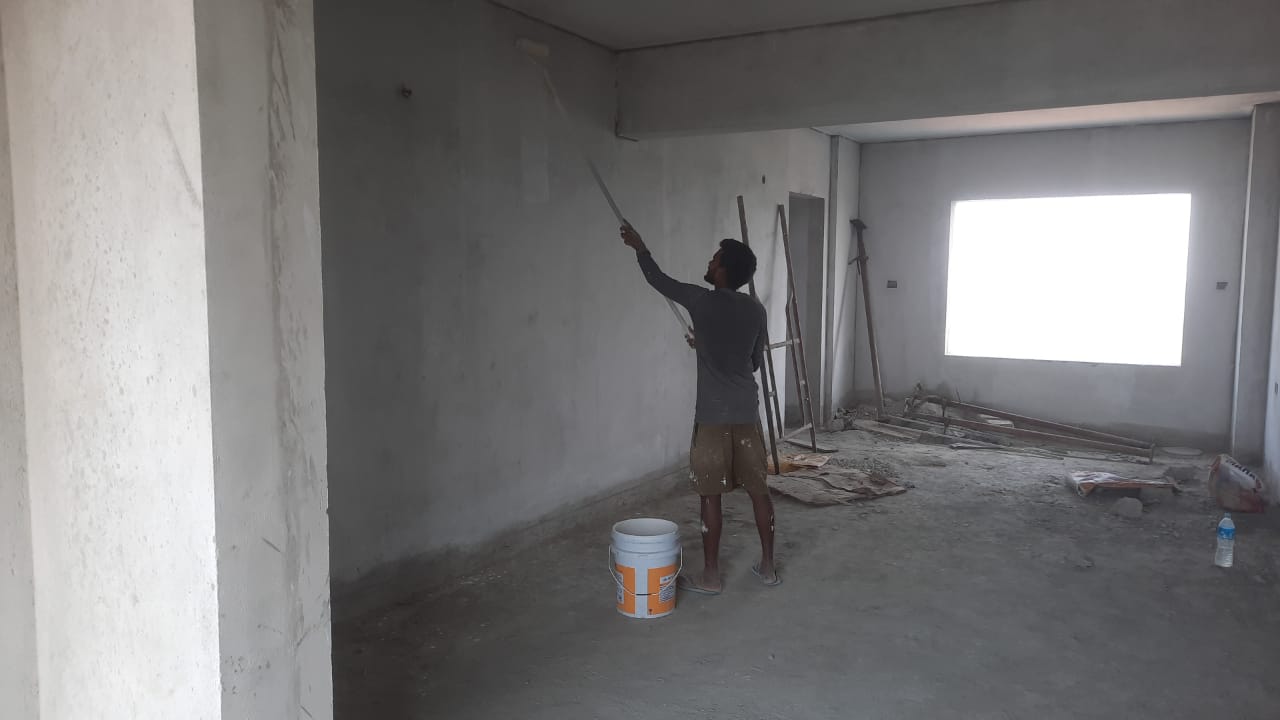

- FIRST COAT PUTTY (INSIDE): upto 11th floor:-100 % Completed.
- RAMP WORK
- WATERPROOFING:
- up to 6th floor toilet -100% completed
- 3rd-floor balcony -100% completed
- PLUMBING WORK: up to 11th-100% Completed
- Piping work: up to 5th, floor-100% completed
- ELECTRICAL WIRE PULLING:2(A)-100% completed,2(B)-40% completed.

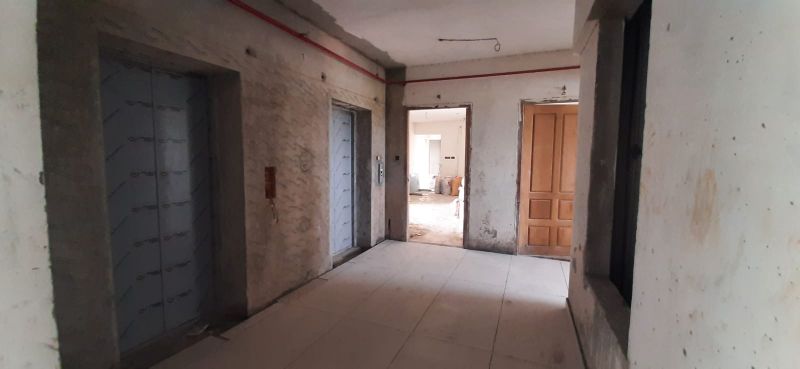

- WALL TILING TOILET:2nd floor (A)-100% completed.
- FABRICATION WORK
- MOCK UP FLAT (2A):
- 2A : Putty work 100% completed
- Balcony Handrail work: completed
- fire piping (2A)-100% completed
- electrical wiring-100% completed
- duct door 2nd floor -100% completed.
- Plumbing( toilet) -100% completed
- Water proofing :- 100% completed.
- floor tile work (2A)-100% completed.
As per the current work status from our site, we are targeted to complete the following works by the end of MARCH 2021.
- SLAB RCC:
- BF Slab RCC Work-100% to be completed.
- SLAB RCC work: 17th:-100% to be completed, 21st floor(amenity) -60% to be completed.
- Column RCC Work:
- 19th floor-100% to be completed.
- 21st floor -60% to be completed
- Ceiling plastering:
- 16th -17th floor-100% to be completed.
- Block Masonry:
- up to 18th floor -100% to be completed
- Wall Chasing:15th – 19th floor:70% to be completed
- BALCONY HANDRAIL WORK:14th -15th floor 100% to be completed
- STAIRCASE HANDRAIL WORK:10th-12th floor main and fire -100% to be completed.
- Internal Wall Plastering: 13th floor-100% to be completed.
- External Wall Plastering:
- 1st -13th floor elevation1,east side-100% to be completed
- 1st -13th floor elevation2, north side-40% to be completed
- FIRST COAT PUTTY (INSIDE): 12th floor – 100% to be completed.
- RAMP WORK: 60% to be completed
- WATER PROOFING:
- 7th-floor toilet -100% to be completed
- 4th-floor balcony -100% to be completed
- PLUMBING WORK:
- 12th-13th-100% to be Completed
- 6th floor-100% to be completed.
- ELECTRICAL WIRE PULLING: 2nd floor-100% to be completed
- WALL TILING TOILET: 2nd floor (B)-100 to be completed.
- FABRICATION WORK: Window grill (2A)-100% to be completed, (2B)-100% to be completed.
- MOCK UP FLAT (2A): fire piping (2BC)-100% to be completed

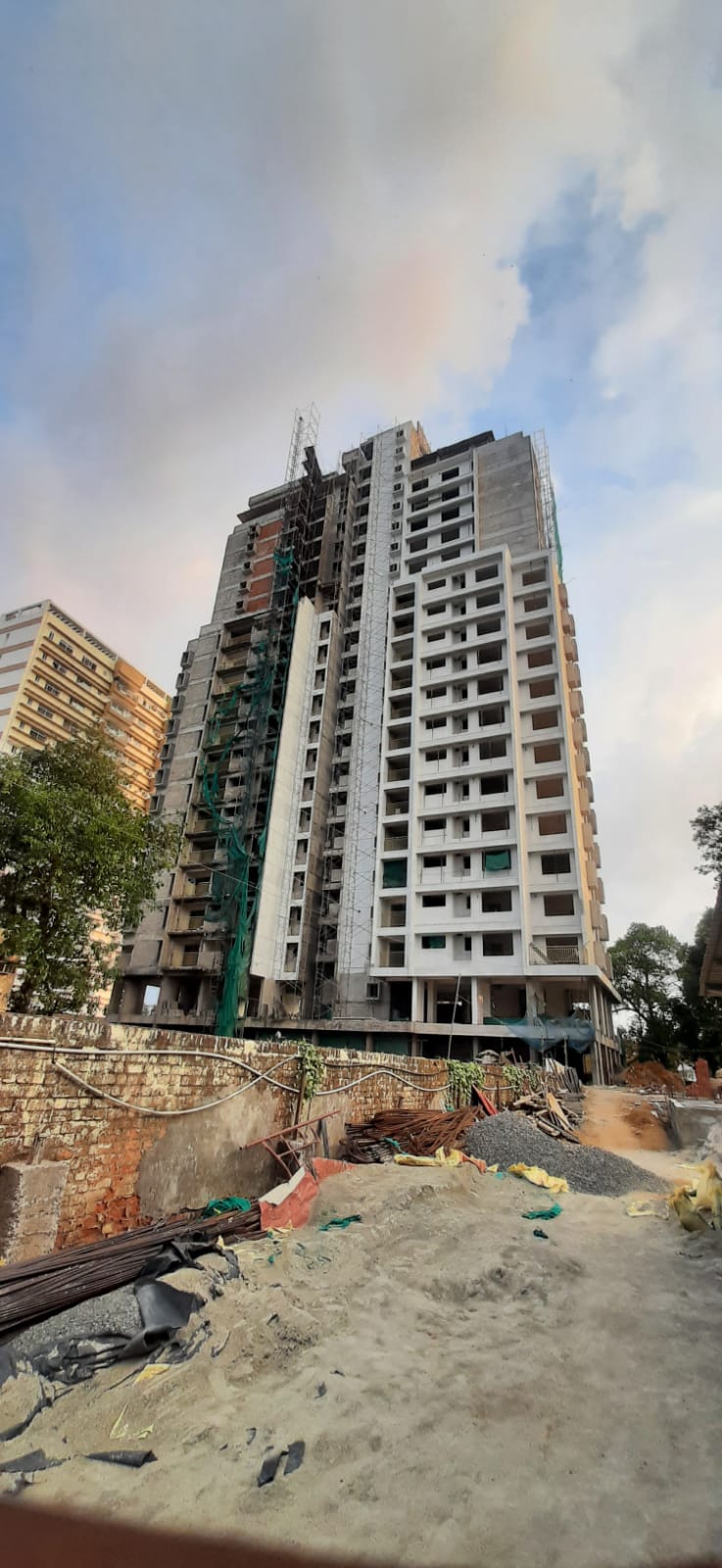

As per the current work status from our site we are targeted to complete the following works by end of February 2021
- SLAB RCC:
- BF Slab RCC Work-100% to be completed.
- SLAB RCC work: 17th:-100% to be completed, 21st floor(amenity) -60% to be completed.
- Column RCC Work:
- 18th floor-100% to be completed.
- 21st floor -60% to be completed
- Ceiling plastering:
- 16th floor-100% to be completed.
- 20th floor(E) -100% to be completed
- Block Masonry:
- 16th floor (F)-100 % to be completed
- 19th floor (E)-100% to be completed
- Wall Chasing: 15th floor:100% to be completed
- Retaining wall work: 450m to be completed (out of 500 m)
- BALCONY HANDRAIL WORK: 14th floor 100% to be completed
- STAIRCASE HANDRAIL WORK: 10th-12th floor main and fire -100% to be completed.
- Internal Wall Plastering: 12th floor-100% to be completed.
- External Wall Plastering:
- 1st -13th floor elevation1,east side-100% to be completed
- 1st -13th floor elevation2, north side-40% to be completed
- FIRST COAT PUTTY (INSIDE): 11th floor – 100% to be completed.
- RAMP WORK: 60% to be completed
- WATER PROOFING:
- 7th-floor toilet -100% to be completed
- 4th-floor balcony -100% to be completed
- PLUMBING WORK:
- 11th-12th-100% to be Completed
- 6th floor-100% to be completed.
- ELECTRICAL WIRE PULLING: 2nd floor-100% to be completed
- WALL TILING TOILET: 2nd floor (B)-100 to be completed.
- FABRICATION WORK: Window grill (2A)-100% to be completed, (2B)-100% to be completed.
- MOCK UP FLAT (2A): fire piping (2ABC)-100% to be completed

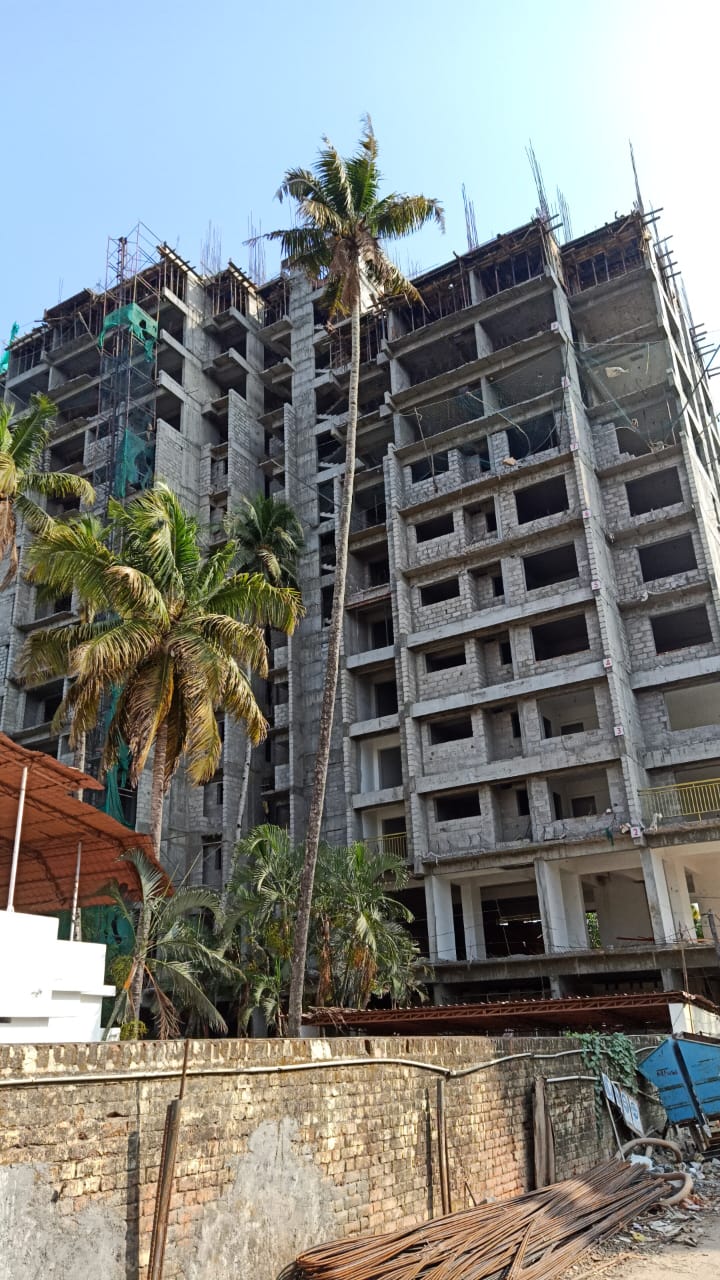

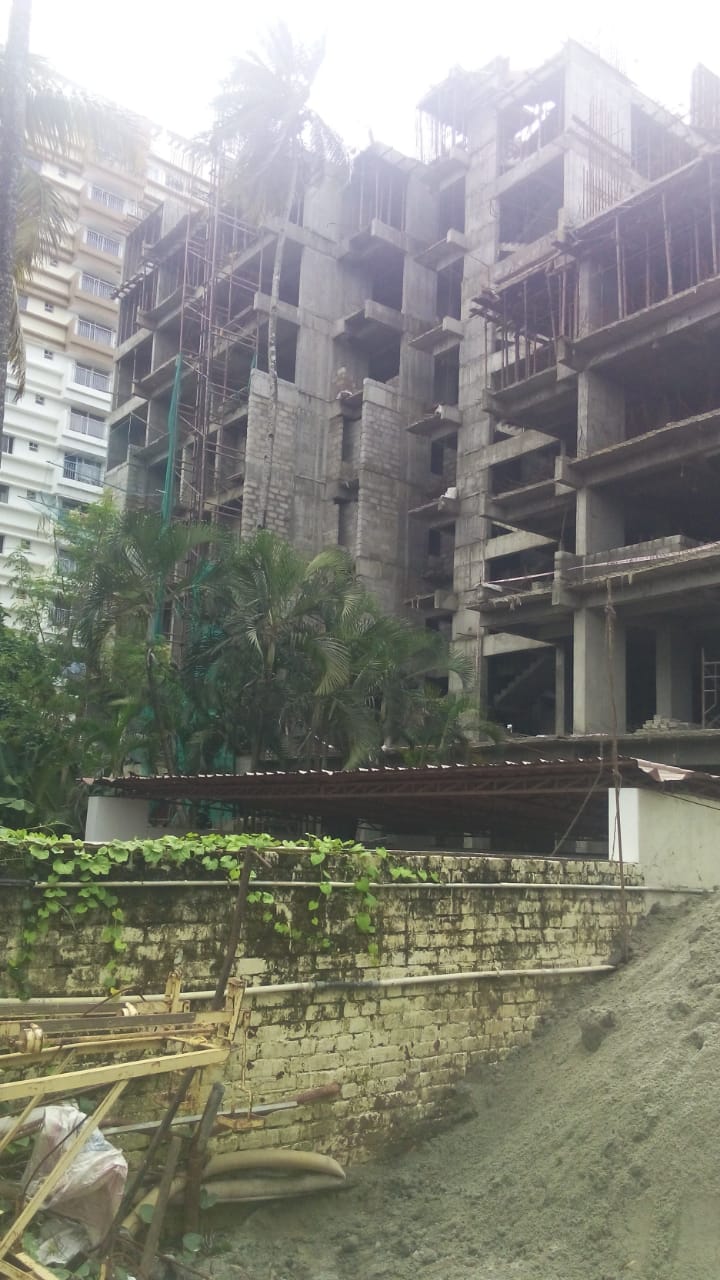

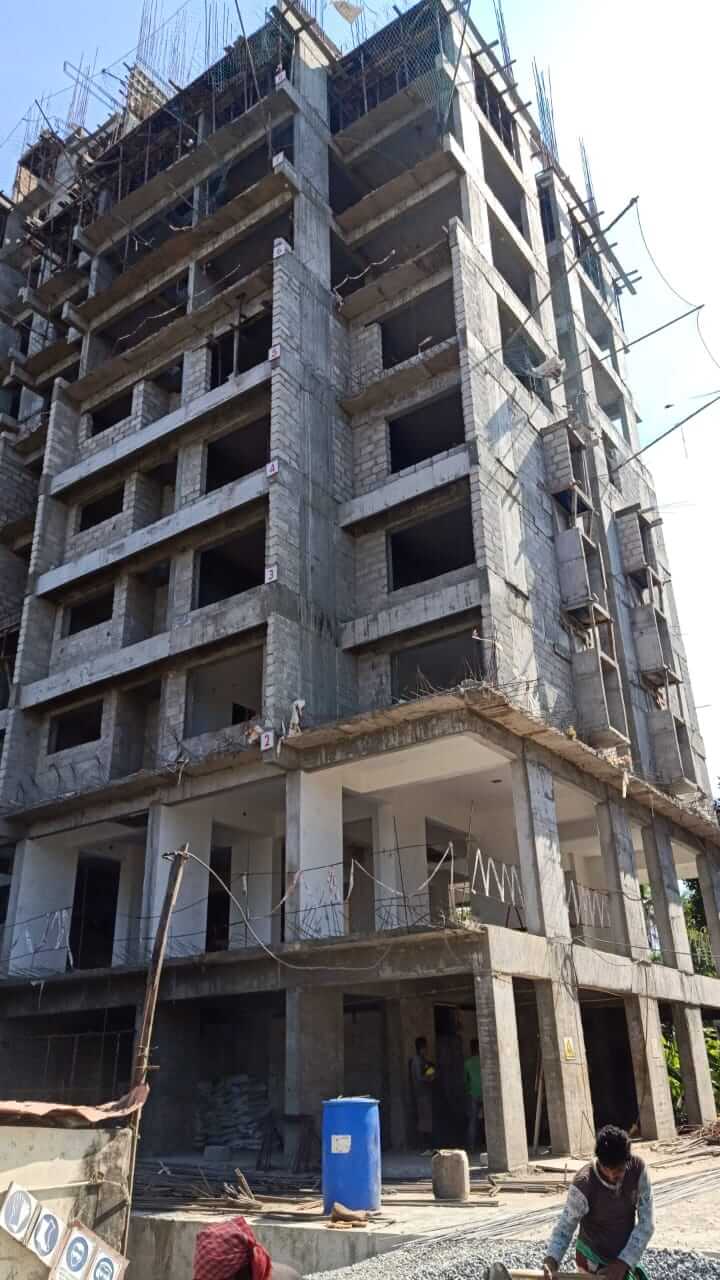

Work status as on 09.02.2021, we have completed the following
- Raft slab-S-E-corner side 100% completed.
- SLAB RCC:
- BF Slab RCC Work-98% completed
- Slab RCC work GF ,FF-95% completed, 2nd -16th floor -100% completed, 17th ,20th floor:-60% completed.
- Column RCC Work :
- 14th floor-16th floor-100% completed.
- 17 floor-20th floor -60% completed
- Ceiling plastering:
- 1st -15th floor -100% completed
- 16th floor (E)-19th floor (E)-100% completed
- Block Masonry:
- 7th -15th floor -100% completed
- 16th-18th floor (E)-100 % completed
- Wall chasing: up to 14th floor:100% completed
- Retaining wall work: Retaining wall work:421m completed (out of 500 m)

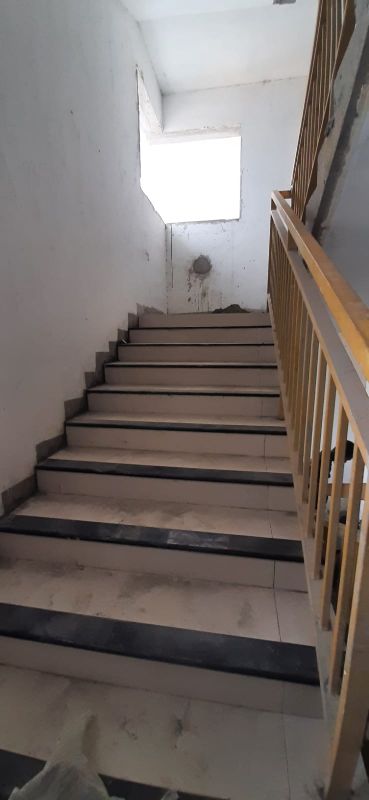

- BALCONY HANDRAIL WORK: up to 13th floor – 100% completed.
- STAIRCASE HANDRAIL WORK: 2nd floor -9th floor main and fire -100% completed.
- Internal Wall Plastering: up to 11th floor, -100% completed.
- External Wall Plastering:
- 1st -13th floor elevation1, east side-60% completed
- 1st -13th floor elevation2, north side-20% completed
- FIRST COAT PUTTY (INSIDE): upto 10th floor:-100 % Completed.
- WATERPROOFING:
- up to 6th floor toilet -100% completed
- 3rd-floor balcony -100% completed
- PLUMBING WORK: up to 10th-100% Completed
- Piping work: up to 5th, floor-100% completed
- ELECTRICAL WIRE PULLING: 2(A)-100% completed,2(B)-40% completed.
- WALL TILING TOILET: 2nd floor (A)-100% completed.
- MOCK UP FLAT (2A):
- 2A : Putty work 100% completed
- Balcony Handrail work: completed
- fire piping (2A)-100% completed
- electrical wiring-100% completed
- duct door 2nd floor -100% completed.
- Plumbing( toilet) -100% completed
- Water proofing :- 100% completed.
- floor tile work (2A)-100% completed.

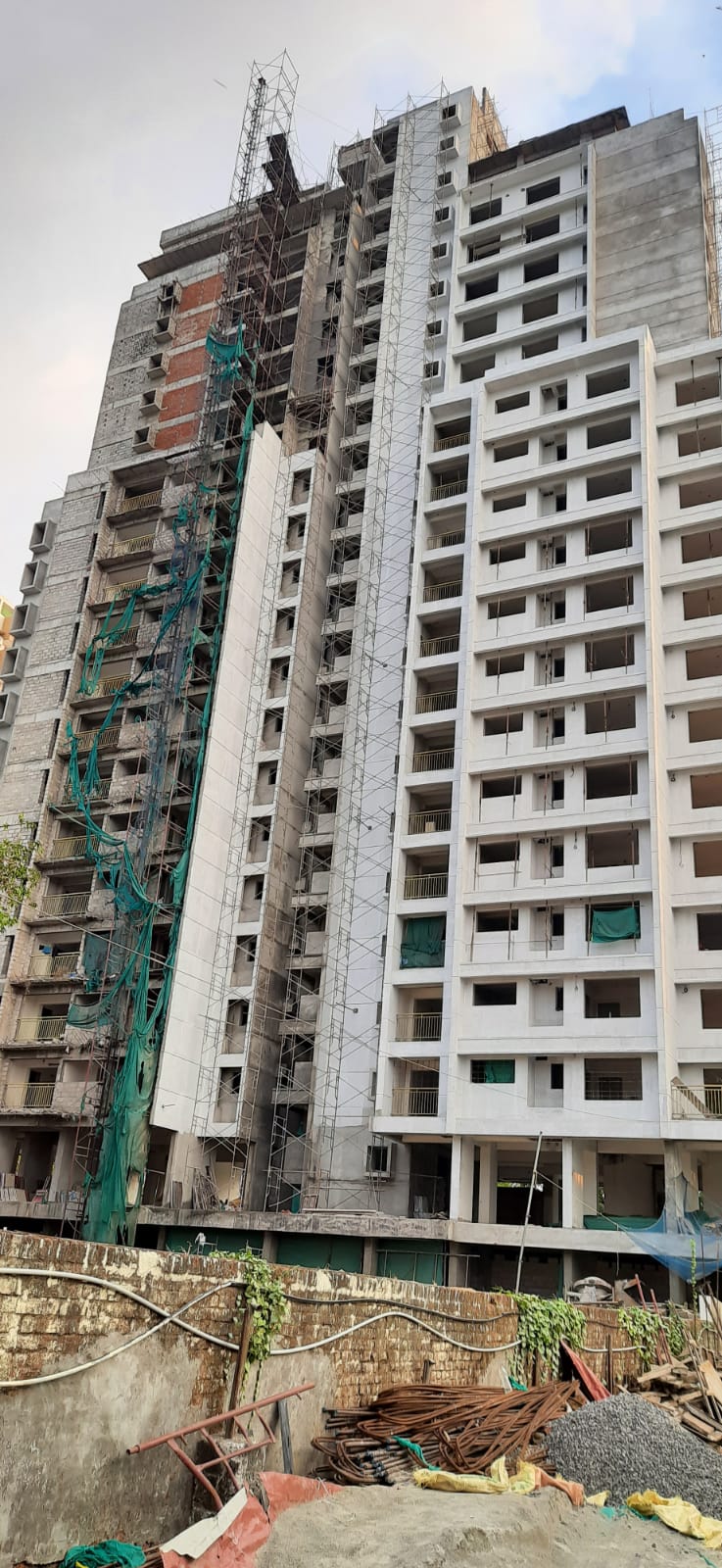

As per the current work status from our site we are targeted to complete the following works by end of June 2020

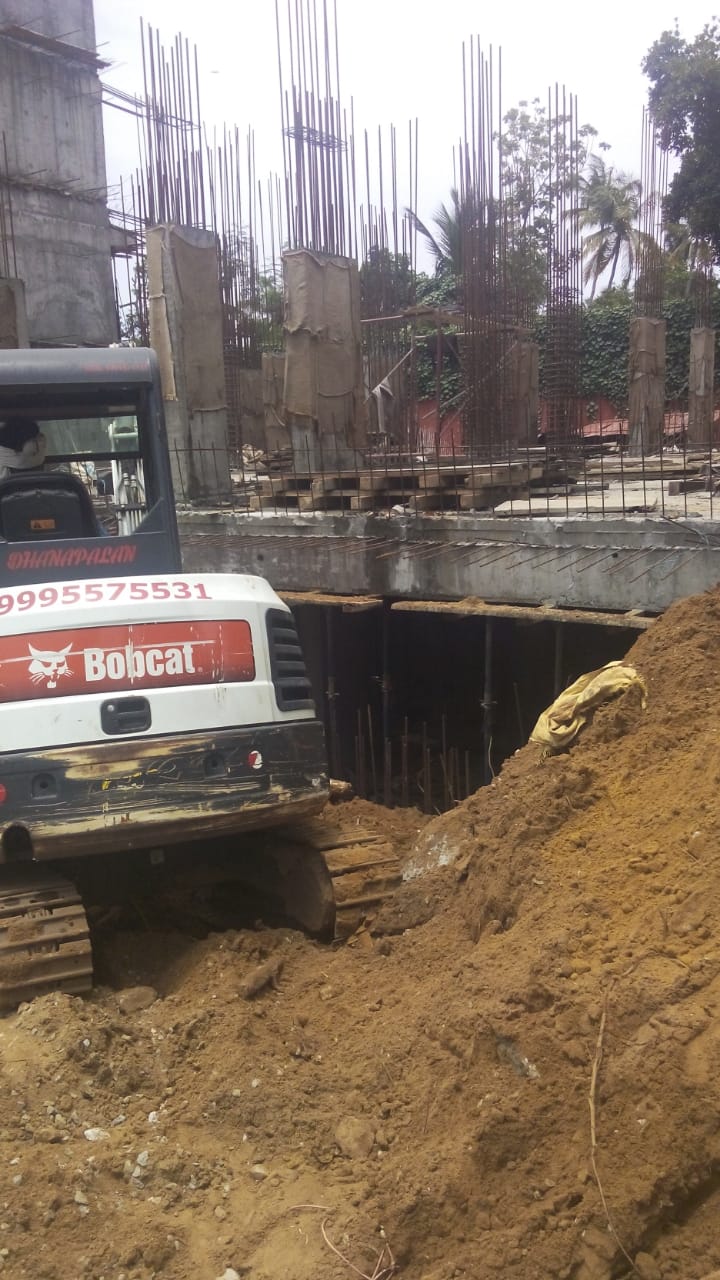

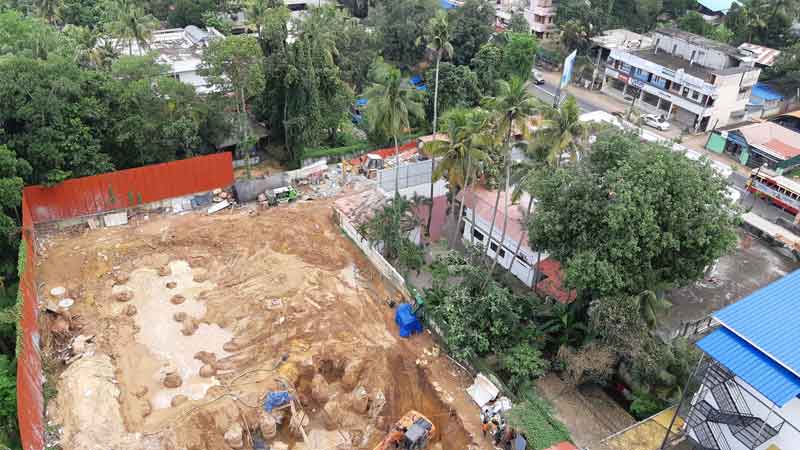

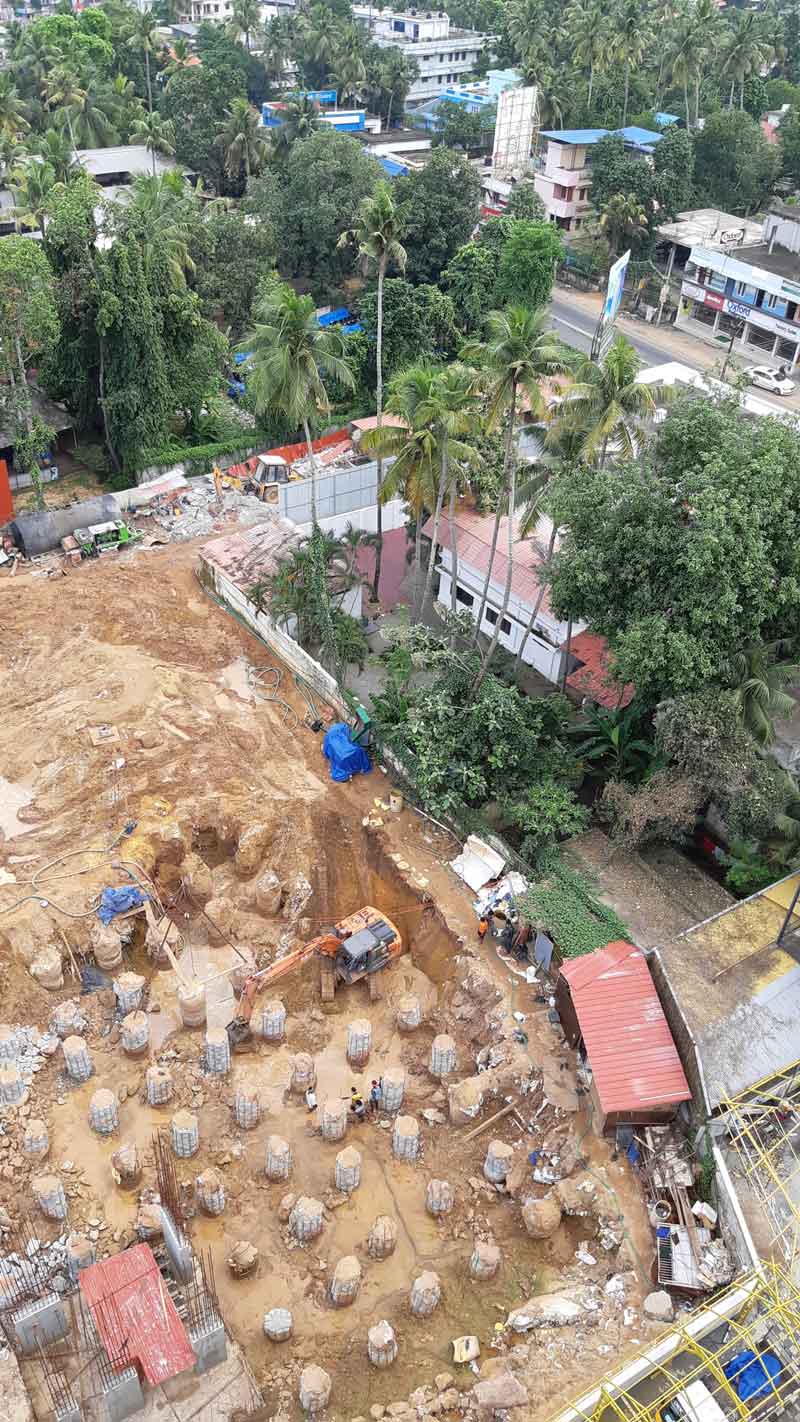

- Pile cap -Building area completed,retaining wall area 25nos completed (out of 26 nos)

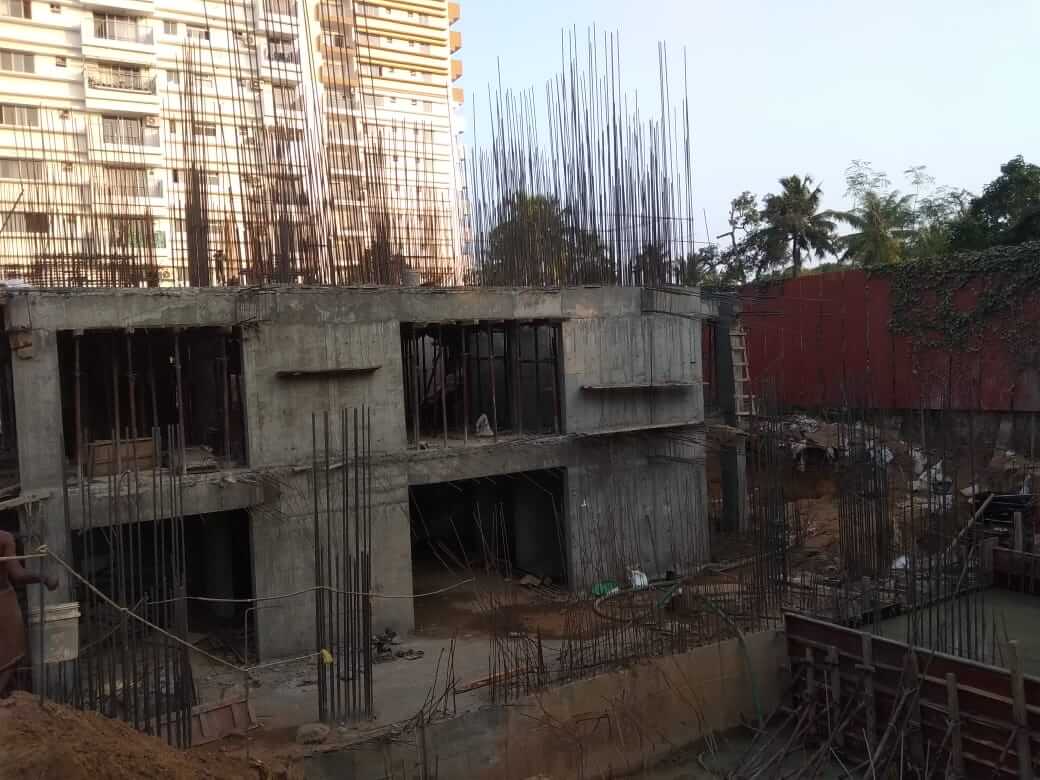

- Raft slab-S-E-corner side 90% completed.
- SLAB RCC:
- BF Slab RCC Work-95% completed
- Slab RCC work GF ,FF-95% completed, 2nd -11th floor -100% completed,12th -14th floor(A,B)-100% completed,15th floor:-70% completed.
- Column RCC Work:
- 1 to -12th Floor -100% completed
- 13th floor- 100% completed
- 14th floor-60% completed.
- 15th floor-60% completed.
- Ceiling plastering:
- Ground floor :90% completed
- 1st -11th floor -100% completed
- 12th floor (A,B)- 100%completed
- Block Masonry:
- 2nd -6th floor-100% completed
- 7th floor(A&B) -100% completed. 7th(C,D)-90% completed.
- 8th floor -100% completed
- 9th floor (A,B)-100% completed
- 10th floor -100% completed
- 11th floor (A,B)-100% completed
- Wall Chasing :
- Second floor :100% completed
- Third Floor :100% Completed
- Forth floor:(A,B,C,D) -100% completed
- Fifth floor :100% completed
- Sixth floor :100% completed
- seventh floor :100% completed
- Retaining wall work: 296m completed (out of 500m)
- BALCONY HANDRAIL WORK :
- 2(A,B,C,D):100% Completed
- 3(A,B,)-60% completed
- STAIRCASE HANDRAIL WORK:
- Fire stair -( GF,1st ,2nd) -100% completed
- Main stair(GF,1st,2nd)-100% completed
- 2nd floor main and fire -100% completed.
- Internal Wall Plastering:
- 2nd – 5th floor(A,B,C,D): -100% completed
- 6th floor(A,B,C,D)-100% completed

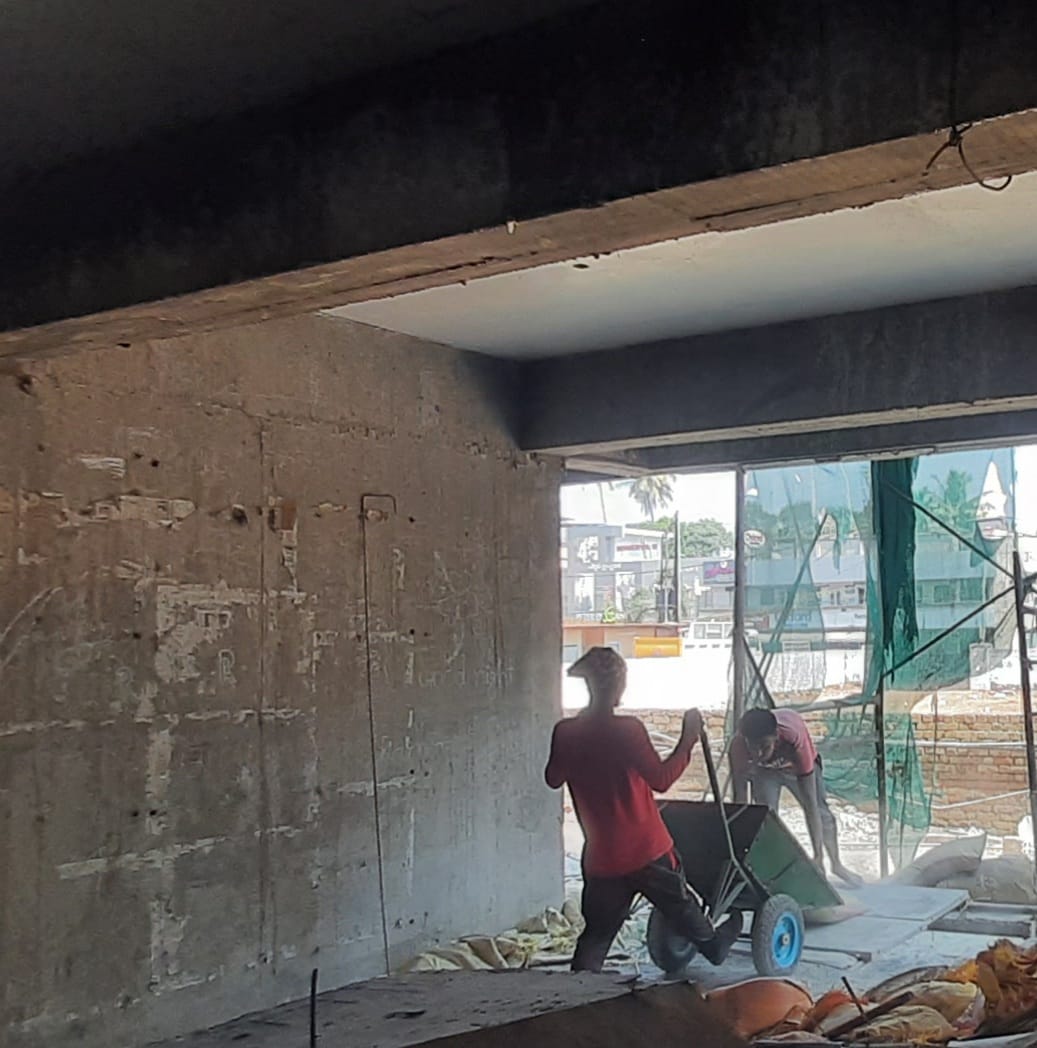

- FIRST COAT PUTTY (INSIDE):
- 2nd floor(A,B,C,D)-100% Completed
- 3rd floor(A,B,C,D)-100% Completed
- 4th floor-(A,B):-100 % Completed, 4(C,D):-50% completed.
- WATER PROOFING:
- 2nd floor(A)toilet -100% completed
- 2nd floor (A)balcony -100% completed
- MOCK UP FLAT (2A):
- 2A : Putty work 100% completed
- Balcony Handrail work: completed
- fire piping-100% completed
- Electrical wiring-100% completed
- Plumbing( toilet) -100% completed
- Water proofing :- 100% completed.

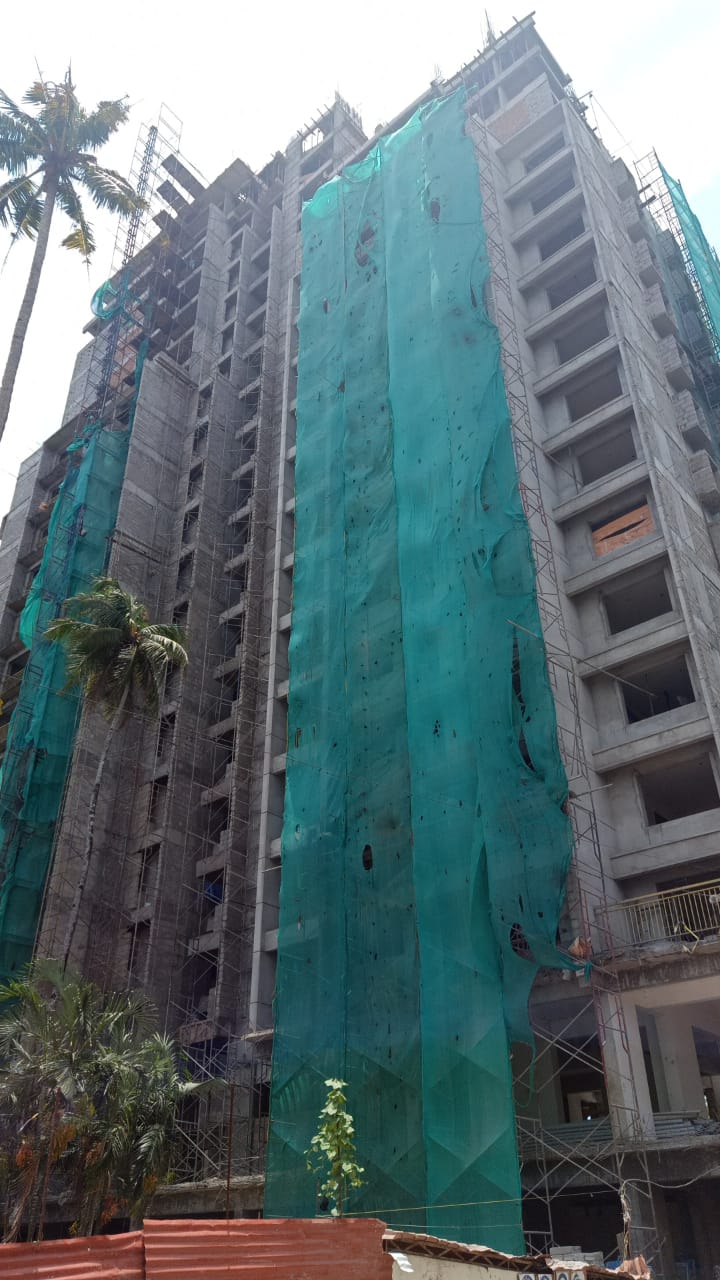

As per the current work status from our site we are targeted to complete the following works by end of March 2020
- Raft slab-100% to be completed
- SLAB RCC work: ,11 th -100% to be completed ,12 th -80% to be completed.,15th floor:-60% to be completed.
- Column RCC Work:
- 13th floor-100% to be completed
- 14th floor-100% to be completed
- 15th floor-60% to be completed
- Ceiling plastering:
- 10th floor -100% to be completed
- 11th floor -100% to be completed
- 12th floor- 100% to be completed
- Block Masonry:
- 7th floor(C&D) -100% to be completed
- 8th floor(C & D)-100% to be completed
- 9th floor (C&D)-100% to be completed
- 10th,11th,12thfloor (A&B )-100% to be completed
- Wall chasing:
- sixth floor :100% to be completed
- seventh floor :100% to be completed
- Retaining wall work: 326m to be completed (out of 500 m)
- BALCONY HANDRAIL WORK: 3(A,B,)-100% to be completed
- STAIRCASE HANDRAIL WORK: 3rd floor main and fire -100% to be completed.
- Internal Wall Plastering: 6th floor(A,B,C,D)-100% to be completed
- FIRST COAT PUTTY (INSIDE ):
- 5th floor(A,B)-100 % to be Completed
- 5th floor (C,D)-80% to be completed
- RAMP WORK: 60% to be completed
- WATERPROOFING: 2nd floor(B)-100% to be completed
- FABRICATION WORK: Window grill (2A)-100% to be completed, (2B)-100% to be completed.
Work status as on 11.03.2020, we have completed the following

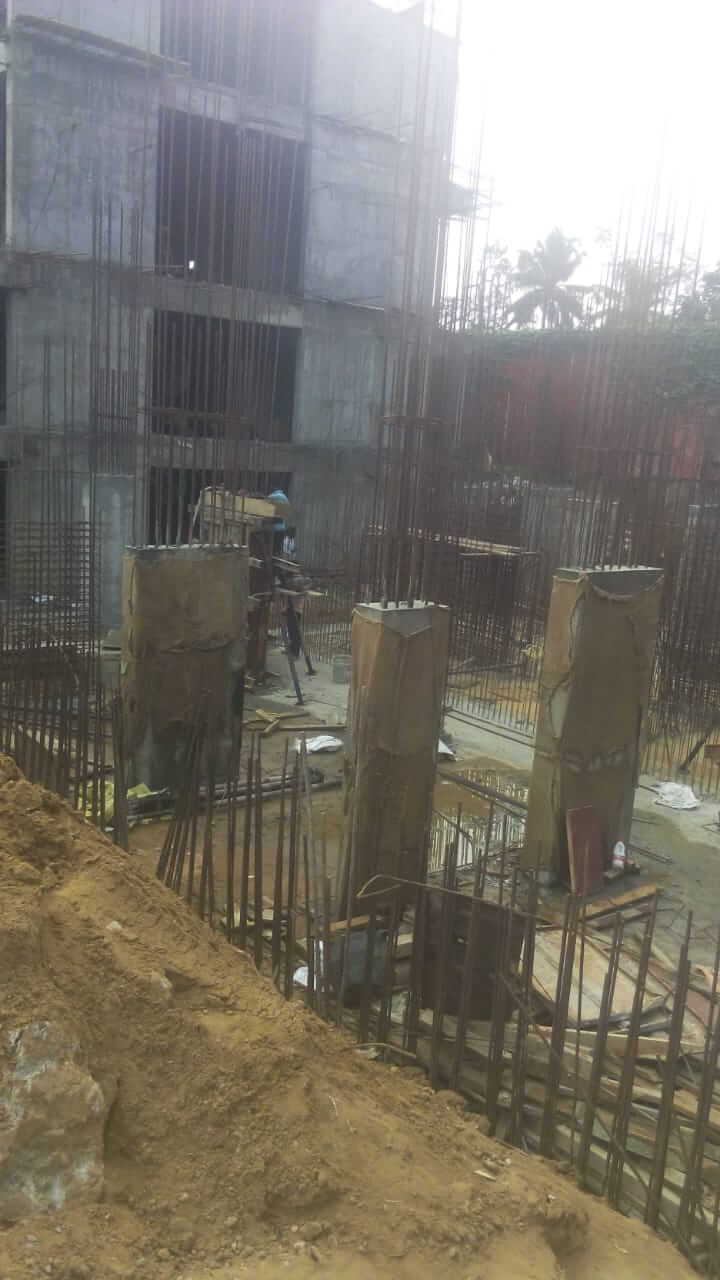

- Pile cap -Building area completed,retaining wall area 21nos completed (out of 26 nos)
- Raft slab-S-E-corner side 80% completed
- SLAB RCC : BF Slab RCC Work-95% completed
- Slab RCC work GF ,FF-95% completed, 2nd-9th floor-100% ,10 th floor -100% completed,11 th -60% completed,12 th -60% completed. 13th &14th floor-60% completed.
- Column RCC Work:
- 1 to -10th Floor -100% completed
- 11th-12th floor -100% completed
- 13th-14 floor-60% completed
- Ceiling plastering:
- Ground floor :90% completed
- 1st -9th floor -100% completed
- 10th -11th floor-60% completed
- Block Masonry:
- 2nd -6th floor-100% completed
- 7th floor(A&B) -100% completed
- 8th floor (A,B)-100% completed
- 9th floor (A,B)-100% completed
- Wall chasing:
- Second floor :100% completed
- Third Floor :100% Completed
- Forth floor:(A,B,C,D) -100% completed
- Fifth floor :100% completed
- Retaining wall work: 296 m completed (out of 500 m)
- BALCONY HANDRAIL WORK: 2(A,B,C,D):100% Completed
- STAIRCASE HANDRAIL WORK:
- Fire stair -( GF,1st ,2nd) -100% completed.
- Main stair(GF,1st,2nd)-100% completed.
- 2nd floor main and fire -100% completed.
- Internal Wall Plastering:
- 2nd floor (A,B,C,D)-100% Completed
- 3rd floor(A,B,C,D)-100% Completed
- 4th floor(A,B,C,D)-100% completed
- 5th floor(A,B,C,D)-100% completed
- FIRST COAT PUTTY (INSIDE ):
- 2nd floor(A,B,C,D)-100% Completed
- 3rd floor(A,B,C,D)-100% Completed
- 3rd floor(C,D)-100 % Completed
- WATERPROOFING:
- 2nd floor(A)toilet -100% completed
- 2nd floor (A)balcony -100% completed
- MOCKUP FLAT (2A):

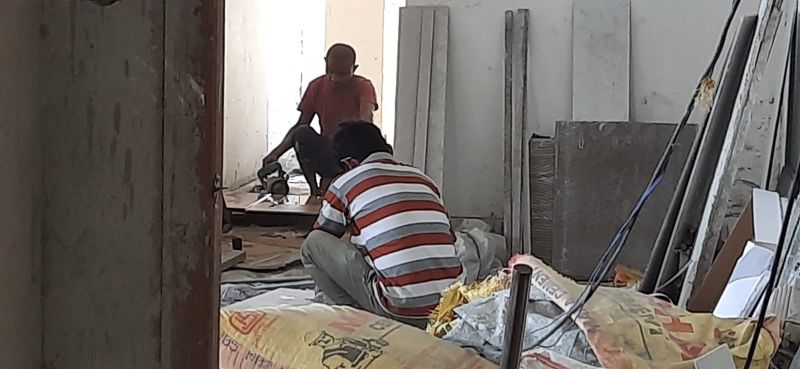

- 2A : Putty work 100% completed
- Balcony Handrail work: completed
- Fire piping-100% completed
- Electrical wiring-100% completed
- Plumbing( toilet) -100% completed
As per the current work status from our site we are targeted to complete the following works by end of February 2020
- Raft slab-70% to be completed
- SLAB RCC work: ,11 th -100% to be completed ,12 th -80% to be completed.,14th floor:-60% to be completed.

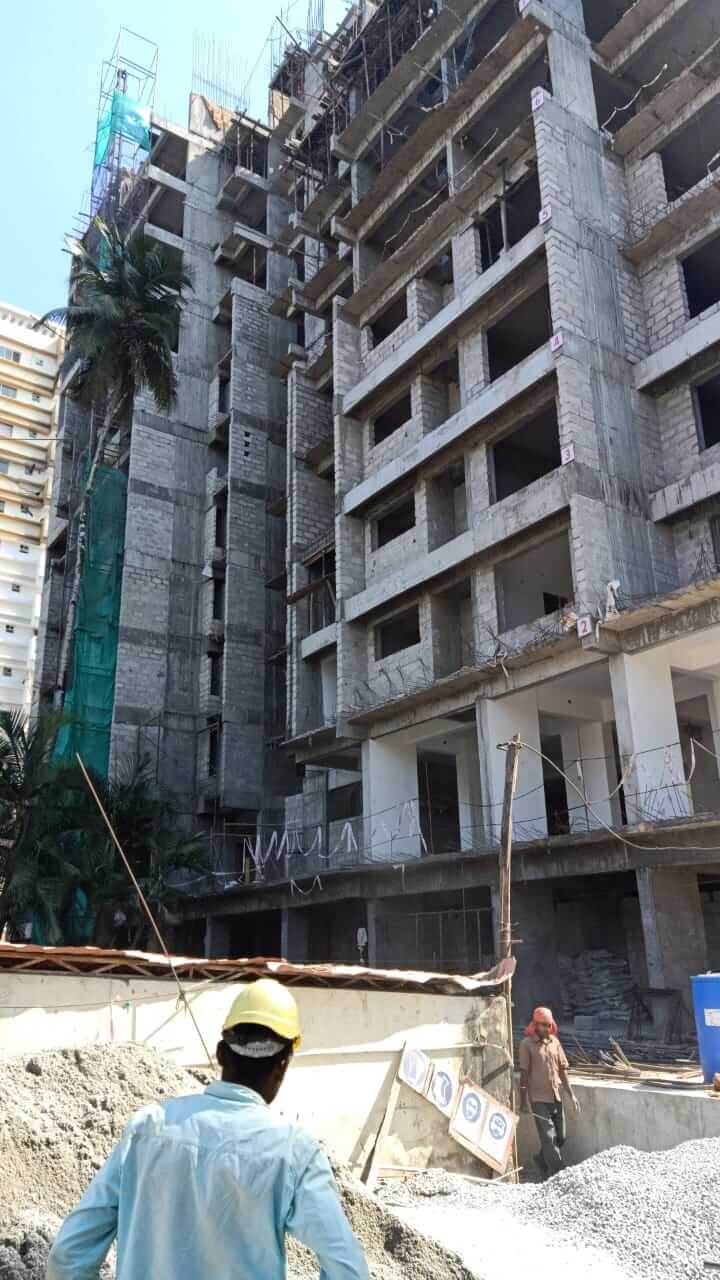

- Column RCC Work:
- 12th floor-100% to be completed
- 13th floor-100% to be completed
- 14th floor-60% to be completed
- Ceiling plastering:
- 9th floor-100% to be completed
- 10th floor -100% to be completed
- 11th floor -100% to be completed
- 12th floor-60% to be completed
- Block Masonry:
- 7th floor(C&D) -100% to be completed
- 8th floor(B,C & D)-100% to be completed
- 9th floor (A&B)-100% to be completed
- 10th floor (A&B )-100% to be completed
- Wall chasing:
- Forth floor:(C&D) -100% to be completed
- sixth floor :100% to be completed
- seventh floor :100% to be completed
- Retaining wall work: 296m to be completed (out of 500 m)

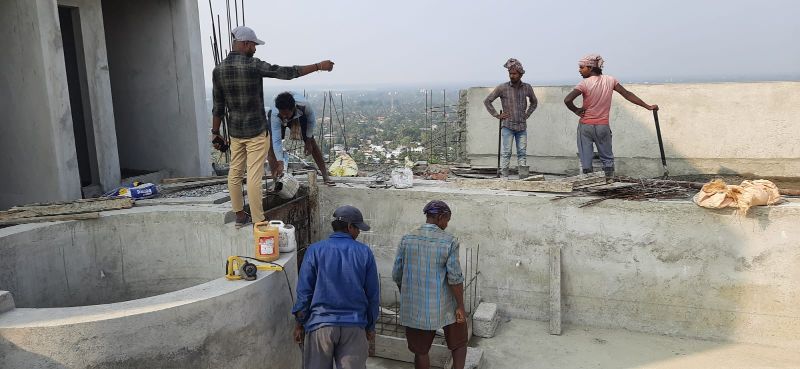

- BALCONY HANDRAIL WORK: 2(B,C,D)-100% to be completed
- STAIRCASE HANDRAIL WORK: 2nd floor main and fire -100% to be completed.
- Internal Wall Plastering: 5th floor(A,B,C,D)-100% to be completed
- FIRST COAT PUTTY (INSIDE ):
- 4th floor(A,B)-100 % to be Completed
- 4th floor (C,D)-80% to be completed
- RAMP WORK: 60% to be completed
- WATERPROOFING: 2nd floor(B)-100% to be completed
- FABRICATION WORK: Window grill (2A)-100% to be completed, (2B)-100% to be completed.
Work status as on 08.02.2020, we have completed the following

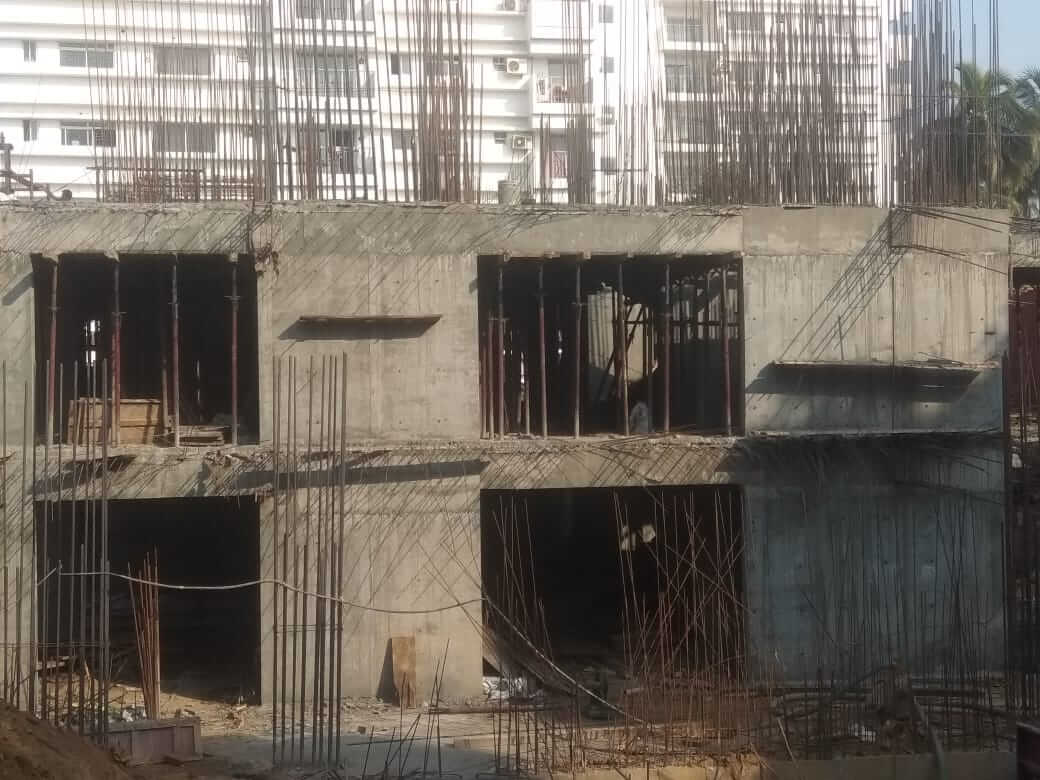

- Pile cap -Building area completed,retaining wall area 21nos completed (out of 26 nos)
- Raft slab-S-E-corner side 50% completed
- SLAB RCC : BF Slab RCC Work-95% completed
- Slab RCC work GF ,FF-95% completed, 2nd-9th floor-100%, 10th floor -100% completed, 11th -60% completed,12th -60% completed. 13th floor-60% completed.
- Column RCC Work:
- 1 to -10th Floor -100% completed
- 11th floor -100% completed
- 12th floor-60% completed
- 13th floor-60% completed
- Ceiling plastering:
- Ground floor :90% completed
- 1st -7th floor -100% completed
- 8th floor-100% completed
- 9th floor-60% completed
- 10th floor-60% completed
- 11th floor-60% completed
- Block Masonry:
- 2nd -5th floor-100% completed
- 6th floor -100% completed
- 7th floor(A&B) -100% completed
- 8th floor (A,B)-100% completed
- 9th floor (A,B)-40% completed
- Wall chasing:
- Second floor :100% completed
- Third Floor :100% Completed
- Forth floor:(A&B) -100% completed
- Fifth floor :100% completed
- Retaining wall work: 196 m completed (out of 500 m)
- BALCONY HANDRAIL WORK: 2A:100% Completed
- STAIRCASE HANDRAIL WORK:
- Fire stair -( GF,1st ,2nd) -100% completed
- Main stair(GF,1st,2nd)-100% completed
- Internal Wall Plastering:
- 2nd floor (A,B,C,D)-100% Completed
- 3rd floor(A,B,C,D)-100% Completed
- 4th floor(A,B,C,D)-100% to be completed
- FIRST COAT PUTTY (INSIDE ):
- 2nd floor(A,B,C,D)-100% Completed
- 3rd floor(A,B,C,D)-100% Completed
- 3rd floor(C,D)-100% Completed
- WATERPROOFING:
- 2nd floor(A)toilet -100% completed
- 2nd floor (A)balcony -100% completed
- MOCKUP FLAT (2A):
- 2A : Putty work 100% completed
- Balcony Handrail work: completed
- fire piping-100% completed
- electrical wiring-100% completed
- Plumbing( toilet) -100% completed

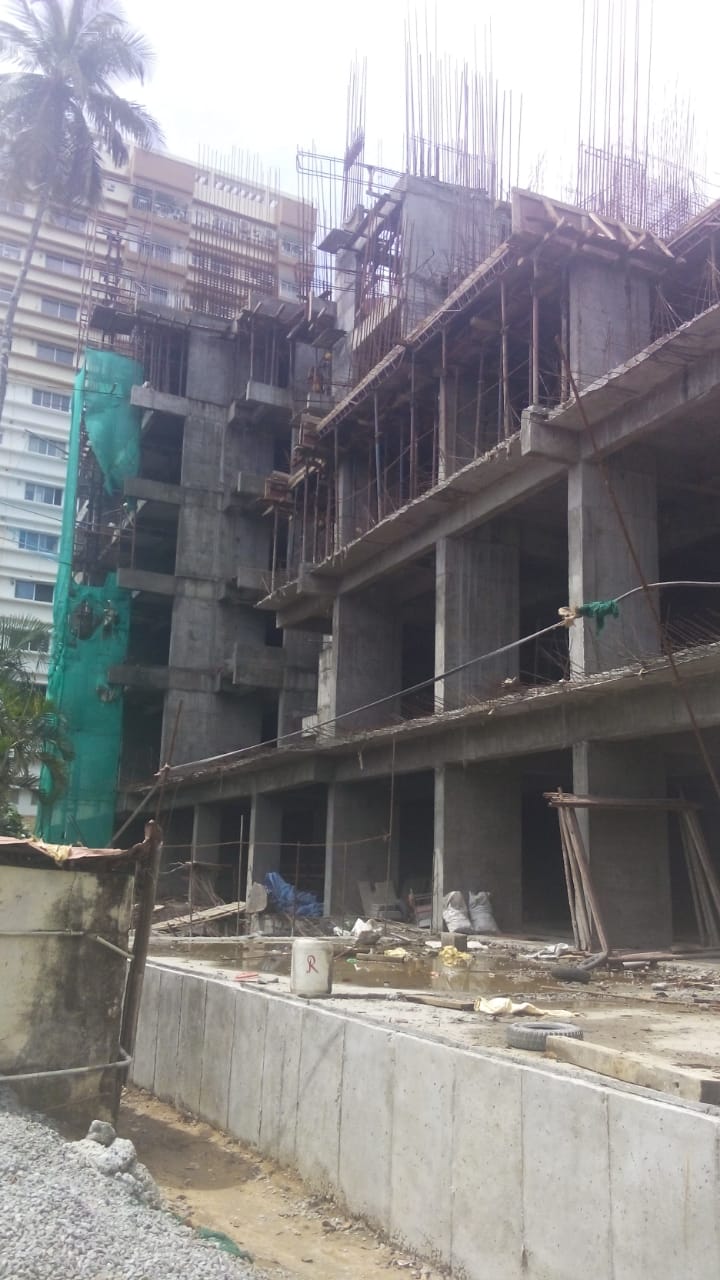

As per the current work status from our site we are targeted to complete the following works by end of January 2020
- Pile cap -Building area completed,retaining wall area 20nos completed (out of 26 nos)
- Raft slab-100% to be completed
- SLAB RCC : 10 th -100%,11 th -80% ,12 th -80% to be completed
- Column RCC Work:
- 10th-11th floor -100% to be completed
- 11th-12th floor-100% to be completed
- 12th-13th floor-100% to be completed
- Ceiling plastering:
- 8th floor-100% to be completed
- 9th floor-100% to be completed
- 10th floor -100% to be completed
- 11th floor-60% to be completed
- 12th floor-60% to be completed
- Block Masonry:
- 6th floor -100% to be completed
- 7th floor(C&D) -100% to be completed
- 8th floor(B,C & D)-100% to be completed
- 9th floor (A&B)-100% to be completed
- 10th floor (A&B )-100% to be completed
- Wall chasing:
- Forth floor:(C&D) -100% to be completed
- Fifth floor :100% to be completed
- Retaining wall work: 170m to be completed (out of 500 m)
- BALCONY HANDRAIL WORK: 2(B,C,D)-100% to be completed
- STAIRCASE HANDRAIL WORK: Main stair(GF,1st,2nd)-100% to be completed
- Internal Wall Plastering: 4th floor(A,B,C,D)-100% to be completed
- FIRST COAT PUTTY (INSIDE ): 3rd floor(C,D)-50 % To beCompleted
- RAMP WORK: 60% to be completed
- FABRICATION WORK: Window grill (2A)-100% to be completed
Work status as on 10.01.2020, we have completed the following
- Pile chipping -100% completed
- Pile cap -Building area completed,retaining wall area 16nos completed (out of 26 nos)
- Raft slab-S-E corner side 40% completed
- SLAB RCC:
- BF Slab RCC Work-95% completed
- Slab RCC work GF ,FF-95% completed, 2nd-9th floor-100% ,10 th floor -60% completed,11 th -60% completed,12 th -60% completed.
- Column RCC Work:
- 1 to -10th Floor -100% completed
- 10th-11th floor -60% completed
- 11th-12th floor-60% completed
- 12th-13th floor-60% completed
- Ceiling plastering:
- Ground floor :90% completed
- 1st -7th floor -100% completed
- 8th floor-60% completed
- 9th floor-60% completed
- 10th floor-60% completed
- Block Masonry:
- 2nd -5th floor-100% completed
- 6th floor -40% completed
- 7th floor(A&B) -100% completed
- 8th floor (A)-100% completed , (B)-60% completed
- Wall chasing:
- Second floor :100% completed
- Third Floor :100% Completed
- Fourth floor:(A&B) -100% completed
- Retaining wall work: 156 m completed (out of 500 m)
- BALCONY HANDRAIL WORK:
- 2A:100% Completed
- STAIRCASE HANDRAIL WORK
- Fire stair -( GF,1st ,2nd) -100% completed
- Internal Wall Plastering
- 2nd floor (A,B,C,D)-100% Completed
- 3rd floor(A,B,C,D)-100% Completed
- FIRST COAT PUTTY (INSIDE ):
- 2nd floor(A,B,C,D)-100% Completed
- 3rd floor(A,B)-100% Completed
- WATERPROOFING: 2nd floor(A)toilet -100% completed
- MOCKUP FLAT (2A):
- 2A : Putty work 100% completed
- Balcony Handrail work: completed
- fire piping-100% completed
- electrical wiring-100% completed
- Plumbing( toilet) -100% completed
As per the current work status from our site we are targeted to complete the following works by end of September 2019
- SLAB RCC work -5 th &6 th -100 % ,9 th -60% ,10 th -40% to be completed
- Ceiling plastering: Sixth floor -75%,7 th -60% ,8 th -40% to be completed
- Block Masonry: Second floor :100% to be completed
- Block Masonry: Third floor :100% completed
- Block Masonry: Fourth floor :80% completed
- Electrical wall chasing: Second floor :100% to be completed
- Electrical wall chasing: Third floor :60% to be completed
- Retaining wall work : 130m to be completed (out of 500m)
Work status as on 05.09.2019, we have completed the following
- Pile chipping -100% completed
- Pile cap -Building area completed,retaining wall area 10nos completed (out of 26 nos)
- BF Slab RCC Work-95% completed
- Slab RCC work GF ,FF-95% completed,SF-100% , 3 rd -100%,4 th -100% ,5 th -100% ,6 th -60% completed ,7 th -60% ,8 th -60%,9 th -50%,10 th floor -40% completed
- Column RCC Work: 1 to -2 nd Floor -100% completed
- Column RCC Work: 2 to -3rd Floor -100% completed
- Column RCC Work: 3rd to -4 th Floor -100% completed
- Column RCC Work: 4 th to -5 th Floor -100% completed
- Column RCC Work: 5th to -6 th Floor -100% completed
- Column RCC Work: 6 th to -7 th Floor -100% completed
- Column RCC Work: 7 th to -8 th Floor -60% completed
- Column RCC Work: 8th to -9 th Floor -60% completed
- Column RCC Work: 9th to -10th Floor -40% completed
- Ceiling plastering: Ground floor :90% completed
- Ceiling plastering: First floor :90% completed
- Ceiling plastering: Second floor :100% completed
- Ceiling plastering: Third floor :75% completed
- Ceiling plastering: Fourth Floor :75% completed
- Ceiling plastering: Fifth floor :75% completed
- Ceiling plastering: Sixth floor :60% completed
- Block Masonry: Second floor :95% completed
- Block Masonry: Third floor :70% completed
- Block Masonry: Fourth floor :70% completed
- Block Masonry: Fifth floor :40% completed
- Electrical wall chasing: Second floor :40% completed
- Retaining wall work :80 m completed (out of 500 m)
As per the current work status from our site we are targeted to complete the following works by end of August 2019
- SLAB RCC work -5 th &6 th -100 % ,9 th -60% ,10 th -40% to be completed
- Column RCC Work : 5th to -6th Floor -100% completed
- Column RCC Work : 6th to -7thFloor -60% to be completed
- Column RCC Work : 8th to 9thFloor , 9th-10th -60% to be completed
- Ceiling plastering: Second floor :100% to be completed
- Ceiling plastering: Third floor :100% tobe completed
- Ceiling plastering: Fourth floor -100% to be completed ,fifth & Sixth floor -100% to be completed
- Block Masonry: Second floor :100% to be completed
- Block Masonry: Third floor :100% completed
- Block Masonry: Fourth floor :100% completed
- Electrical wall chasing: First floor :100% to be completed
- Electrical wall chasing: Second floor :100% to be completed
- Electrical wall chasing: Third floor :100% to be completed
- Retaining wall work :70m to be completed (out of 500 m)
Work status as on 05.08.2019, we have completed the following
- Pile chipping -100% completed
- Pile cap -Building area completed,retaining wall area 10nos completed (out of 26 nos)
- BF Slab RCC Work-95% completed
- Slab RCC work GF ,FF-95% completed,SF-100% , 3 rd -100%,4 th -100% ,5 th -60% ,6 th -60% completed ,7 th -60% ,8 th -60%,9 th -40%
- Column RCC Work: 1 to -2 nd Floor -100% completed
- Column RCC Work: 2 to -3rd Floor -100% completed
- Column RCC Work: 3rd to -4 th Floor -100% completed
- Column RCC Work: 4 th to -5 th Floor -100% completed
- Column RCC Work: 5th to -6 th Floor -60% completed
- Column RCC Work: 6 th to -7 th Floor -60% completed
- Column RCC Work: 7 th to -8 th Floor -60% completed
- Column RCC Work: 8th to -9 th Floor -40% completed
- Ceiling plastering: Ground floor :90% completed
- Ceiling plastering: First floor :90% completed
- Ceiling plastering: Second floor :75% completed
- Ceiling plastering: Third floor :75% completed
- Ceiling plastering: Fourth Floor :75% completed
- Block Masonry: Second floor :95% completed
- Block Masonry: Third floor :60% completed
- Block Masonry: Fourth floor :40% completed
- Retaining wall work :50 m completed (out of 500 m)
As per the current work status from our site we are targeted to complete the following works by end of July 2019
- SLAB RCC work -7 th & 8 th Floor -60% completed.
- Column RCC Work : 2 to -3rd Floor -100% to be completed
- Column RCC Work : 3rd to -4 th Floor -100% to be completed
- Column RCC Work : 6 th to -7 thFloor -60% to be completed
- Ceiling plastering: Ground floor :75% to be ompleted
- Ceiling plastering: First floor :75% to be completed
- Ceiling plastering: Second floor :100% to be completed
- Ceiling plastering: Fourth floor :75% to be completed
- Block Masonry: Second floor :60% to be completed
- Block Masonry: Third floor :40% to be completed
- Electrical wall chasing: First floor :60% to be completed
- Electrical wall chasing: Second floor :60% to be completed
- Retaining wall work :60m to be completed (out of 500 m)
Work status as on 06.07.2019, we have completed the following
- Pile chipping -100% completed
- Pile cap -Building area completed,retaining wall area 10nos completed (out of 26 nos)

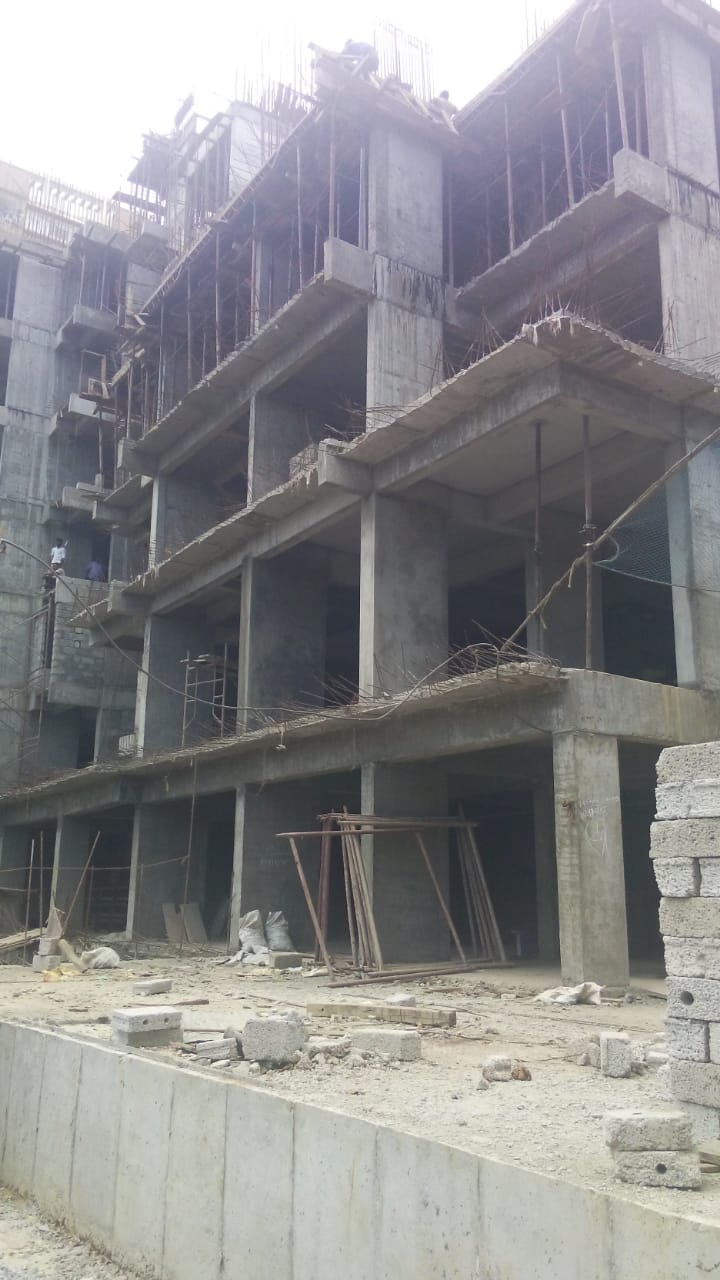

- BF Slab RCC Work-95% completed
- Slab RCC work GF ,FF-95% completed,SF-100% , 3 rd -85%,4 th -75% ,5 th -60% ,6 th -60% completed
- Column RCC Work: 1 to -2 nd Floor -100% completed
- Column RCC Work: 2 to -3rd Floor -95% completed
- Column RCC Work: 3rd to -4 th Floor -75% completed
- Column RCC Work: 4 th to -5 th Floor -60% completed

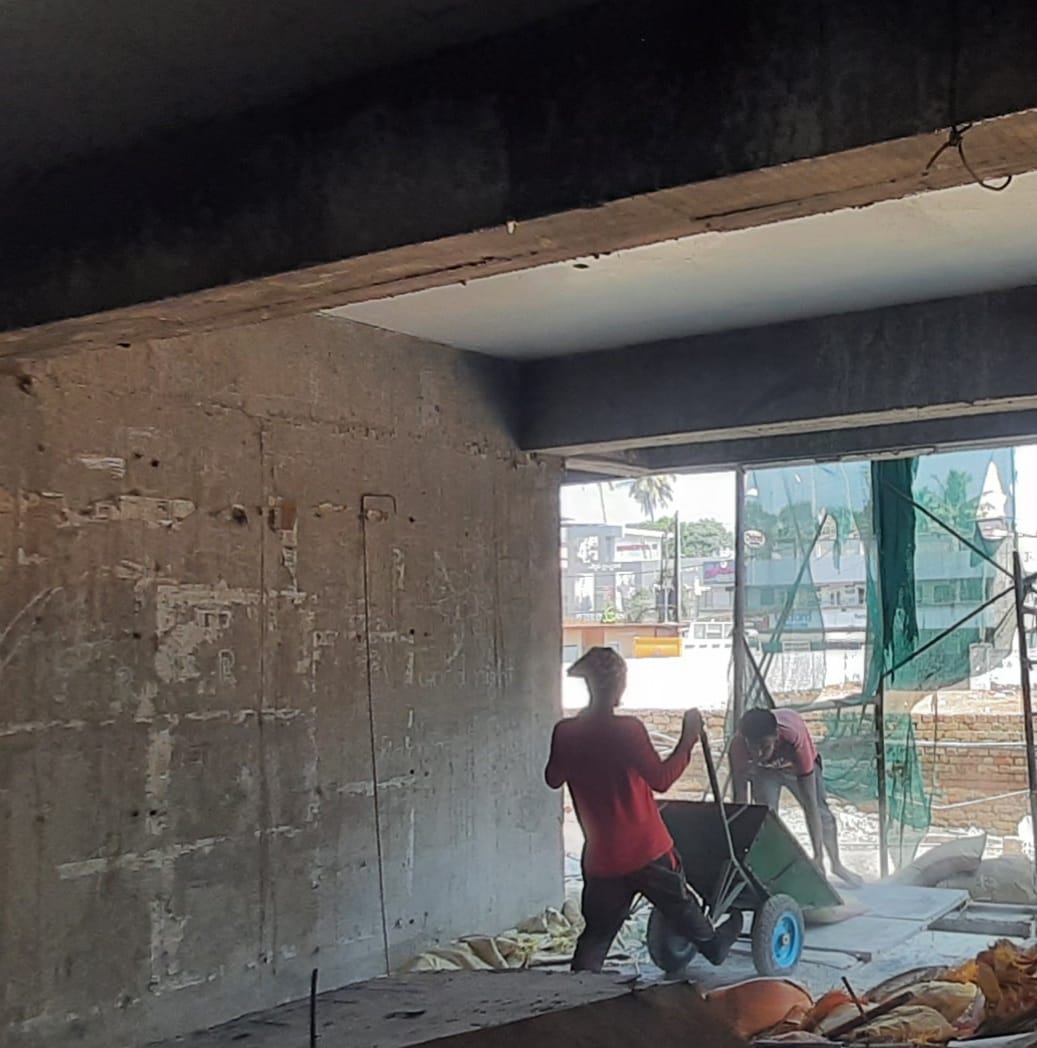

- Ceiling plastering: Ground floor :60% completed
- Ceiling plastering: First floor :70% completed
- Ceiling plastering: Second floor :75% completed
- Ceiling plastering: Third floor :75% completed
- Block Masonry: Second floor :40% completed
- Retaining wall work :30 m completed (out of 500 m)
As per the current work status from our site we are targeted to complete the following works by end of June 2019
- pile cap (Retaining wall area)-15nos to be completed out of 26 nos
- BF Slab RCC Work-95% to be completed
- GF Slab RCC Work-95% to be completed
- second floor Slab -90% to be completed
- Column work -FF-SF Column work -100% to be completed,2nd -3rd Column work- 100% completed,4 th -5 th floor Column work -60% completed.
- Ceiling plastering- 1st floor -75% to be completed ,2 nd floor -75% to be completed
- Brick masonry work -2 nd floor -40% to be completed
- Electrical chasing work -2 nd floor -40% to be completed
Work status as on 06.06.2019, we have completed the following
- Pile chipping -100% completed
- Pile cap -Building area completed,retaining wall area 9nos completed (out of 26 nos)
- BF Slab RCC Work-90% completed
- GF ,FF slab RCC work -90% completed
- 2 nd ,3 rd,4 th floor Slab RCC Work-75% completed
- GF-FF Column work -100% completed,FF-SF Column work -85% completed,2ND-3RD Column work -85% completed,3 rd -4 TH Column work -75% completed.
- Ceiling plastering- 1st floor -60% completed ,2 nd floor -40% completed
As per the current work status from our site we are targeted to complete the following works by end of May 2019
- pile cap (Retaining wall area)-11 nos to be completed out of 26 nos
- BF Slab RCC Work-90% to be completed
- First floor Slab -90% to be completed
- Fourth floor slab & fifth floor slab RCC Work-60% to be completed.
- BF -GF Column work -90% to be completed
- GF-FF Column work -90% to be completed,4 th to 5 th floor column -60% to be completed.
- Ceiling plastering 1& 2 nd floor -60% to be completed
- Brick masonry work -2 nd floor -40% to be completed
- Electrical chasing work -2 nd floor -40% to be completed
Work status as on 06.05.2019, we have completed the following
- Pile chipping -100% completed
- Pile cap -Building area completed,retaining wall area 6 nos completed (out of 26 nos)

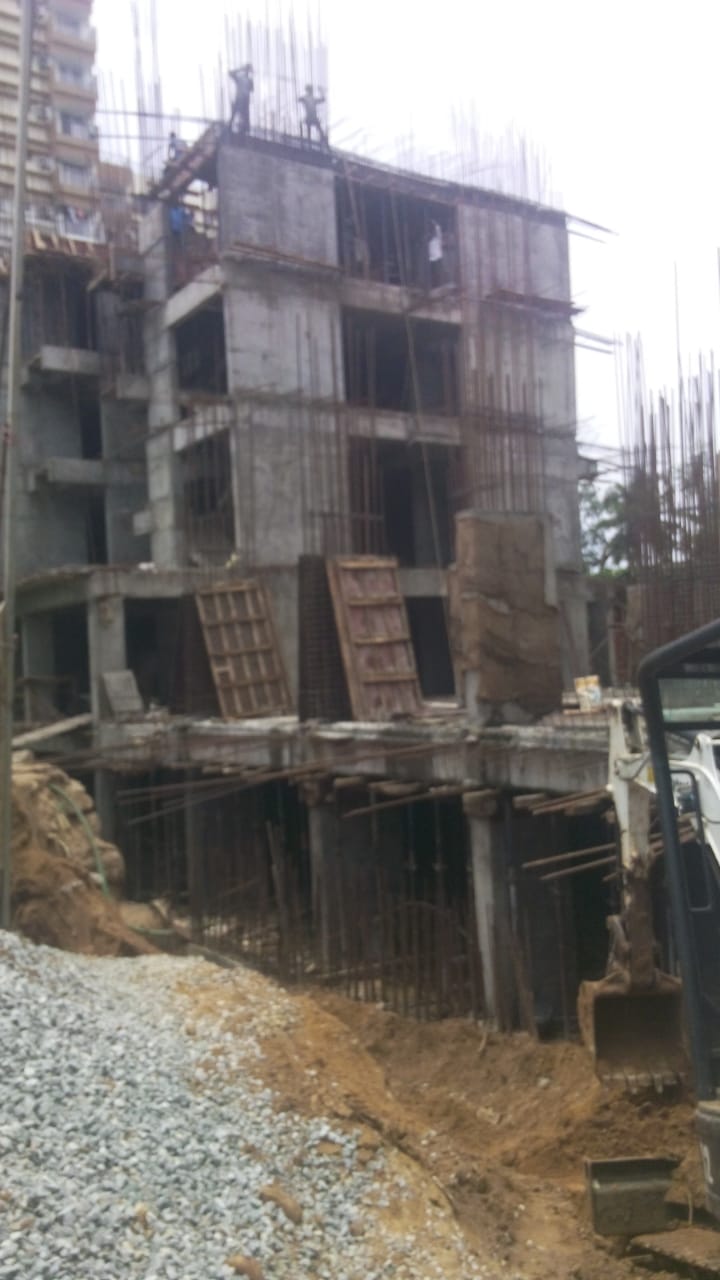

- BF Slab RCC Work-80% completed
- GF slab RCC work – 80% completed
- FF,SF,TF Slab RCC Work-75% completed
- Fourth floor slab RCC Work-Shuttering completed
- BF -GF Column work -80% completed
- GF-FF Column work -70% completed,FF-SF Column work -60% completed,2ND-3RD Column work -60% completed,3 RD-4 TH Column work -60% completed.
As per the current work status from our site we are targeted to complete the following works by end of April 2019
- BF Slab RCC Work-100% to be completed
- GF slab RCC work – 100% to be completed
- FF Slab RCC Work-100% to be completed,SF,TF-65% to be completed,Forth floor slab -60% to be completed.
- Column RCC work (Building)basement – 100% to be completed
- Column RCC work (Building) Ground- 100% to be completed (out of 53)
- Column RCC work (Building) First floor-65% Completed,SF (65% to be completed),TF Column -60% tobe completed)
Work status as on 05.04.2019, we have completed the following
- Piling work – 100% completed
- Pile chipping – 100% completed (out of 148)
- Pile chipping – Retaining wall area 6completed(out of 26)
- Pile cap (retaining wall area) – 6completed(out of 26)
- Pile cap work – 13nos completed (out of 14);
- BF Slab RCC Work-80% completed
- GF slab RCC work – 75% completed
- FF Slab RCC Work-75% completed
- Column RCC work (Building)basement – 80% completed
- Column RCC work (Building) Ground-90% completed (out of 53)
- Column RCC work (Building) First floor-40% Completed
As per the current work status from our site we are targeted to complete the following works by end of March 2019
- Pile chipping – 148 to be completed (out of 148)
- BF Slab RCC Work-100% to be completed
- GF slab RCC work – 100% to be completed
- FF Slab RCC Work-70% to be completed
- Column RCC work (Building)basement – 100% to be completed
- Column RCC work (Building) Ground- 100% to be completed (out of 53)
Work status as on 06-03-2019, we have completed the following
- Piling work – 100% completed
- Pile chipping – 142 nos completed (out of 148)
- Pile chipping – Retaining wall area 3 completed(out of 26)
- Pile cap work – 13nos completed (out of 14);
- BF Slab RCC Work-70% completed
- GF slab RCC work – 70% completed
- FF Slab RCC Work-40% completed
- Column RCC work (Building)basement – 80% completed
- Column RCC work (Building) Ground- 65% completed (out of 53)
- Column RCC work (Building) First floor-40% Completed
As per the current work status from our site we are targeted to complete the following works by end of February 2019
- BF Slab RCC Work-100% to be completed
- GF slab RCC work – 100% to be completed
- Column RCC work (Building)basement – 100% to be completed
Work status as on 05-02-2019, we have completed the following
- Piling work – 100% completed
- Pile chipping – 112 nos completed (out of 148)
- Pile chipping – Retaining wall area 3completed(out of 26)
- Pile cap work – 11nos completed (out of 14);
- BF Slab RCC Work-50% completed
- GF slab RCC work – 50% completed
- FF Slab RCC Work-50% completed
- Column RCC work (Building)basement – 60% completed
- Column RCC work (Building) Ground- 60% completed (out of 53)
- Column RCC work (Building) First floor- 30% Completed
As per the current work status from our site we are targeted to complete the following works by end of January 2019
- BF Slab RCC Work-60% to be completed
- GF slab RCC work – 60% to be completed
Work status as on 08-01-2019, we have completed the following
- Piling work – 100% completed
- Pile chipping – 112 nos completed (out of 148)
- Pile chipping – Retaining wall area 3completed(out of 26)
- Pile cap work – 10nos completed (out of 14);
- BF Slab RCC Work-45% completed
- GF slab RCC work – 40% completed
- FF Slab RCC Work-40% completed
- Column RCC work (Building)basement – 31nos completed (out of 53)
- Column RCC work (Building) Ground- 19nos completed (out of 53)
As per the current work status from our site we are targeted to complete the following works by end of December 2019
- Pile chipping – 122 nos to be completed (out of 148)
- Pile cap work – 11nos to be completed (out of 14)
- GF slab RCC work – 60% to be completed
- FF Slab RCC Work-20%to be completed
Work status as on 06-12-2018, we have completed the following
- Piling work – 100% completed
- Pile chipping – 102 nos completed (out of 148)
- Pile chipping – Retaining wall area 2 completed(out of 26)
- Pile cap work – 8nos completed (out of 14);
- GF slab RCC work – 40% completed
- FF Slab RCC Work-on progress
- Column RCC work (Building)basement – 19nos completed (out of 53)
- Column RCC work (Building) Ground- 15nos completed (out of 53)
As per the current work status from our site we are targeted to complete the following works by end of November 2018
- Pile chipping – 100 nos to be completed (out of 148)
- Pile cap work – 6nos to be completed (out of 14)
- GF slab RCC work – 60% to be completed
- Column RCC work (Building) – 28 nos to be completed (out of 52)
Work status as on 16-11-2018, we have completed the following.
- Piling work – 100% completed
- Pile chipping – 85 nos completed (out of 148)
- Pile cap work – 5nos completed (out of 14);
- GF slab RCC work – 30% completed
- Column RCC work (Building) – 19nos completed (out of 53)
Work Schedule for the Month of July 2018
- Pile chipping – 60nos to be completed (out of 148)
- Pile cap work – 4nos to be completed (out of 14)
- Column RCC work (Building) – 8 nos to be completed (out of 52)
Work status as on 05-06-2018, we have completed the following.
- Piling work – 100% completed
- Pile chipping – 40 nos completed (out of 148)
- Pile cap work – 1no completed (out of 14)
- Column RCC work (Building) – 5 nos completed (out of 52)
Work Schedule for the Month of June 2018
- Piling work – 158 nos completed (out of 174)
- Pile chipping – 9 nos completed (out of 148)
- Pile cap work – 1no completed (out of 14)
- Column RCC work (Building) – 5 nos completed (out of 52)
As per the current work status from our site we are targeted to complete the following works by end of June 2018
- Piling work – 100% to be completed
- Pile chipping – 18 nos to be completed (out of 148)
- Column RCC work (Building) – 8 nos to be completed (out of 52)
As per the current work status from our site we are targeted to complete the following works by end of March 2018
- Piling work -134 to be completed (out of 174)
Work status as on 1 3 -03 -2018, we have completed.
- Piling work – 104 nos completed (out of 174)
