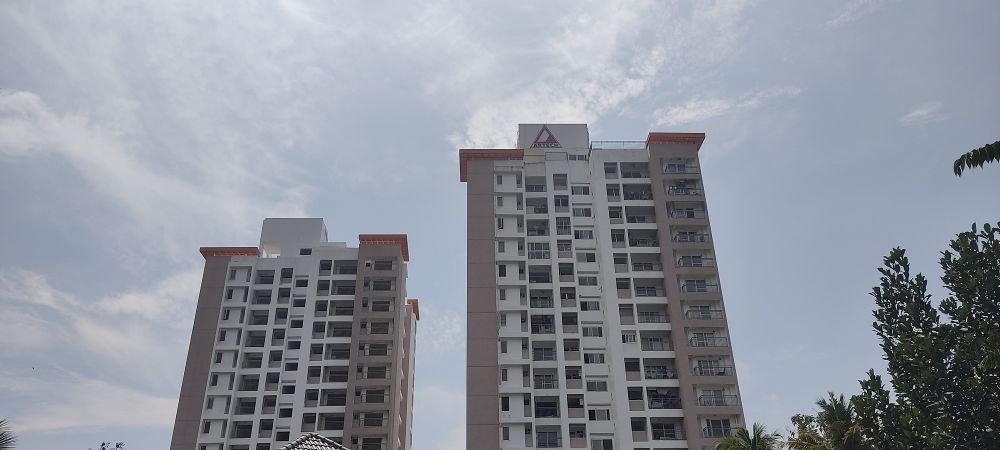

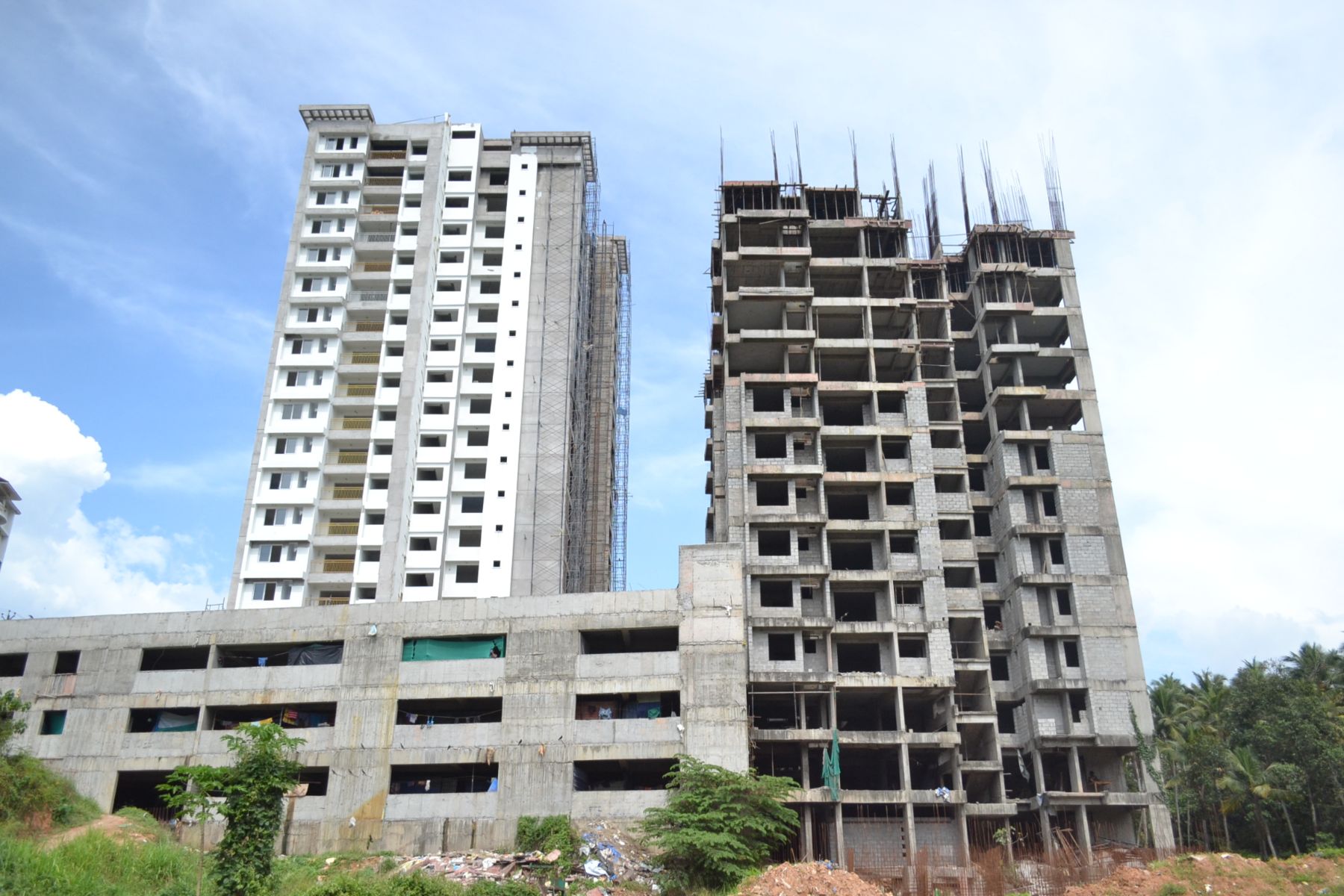

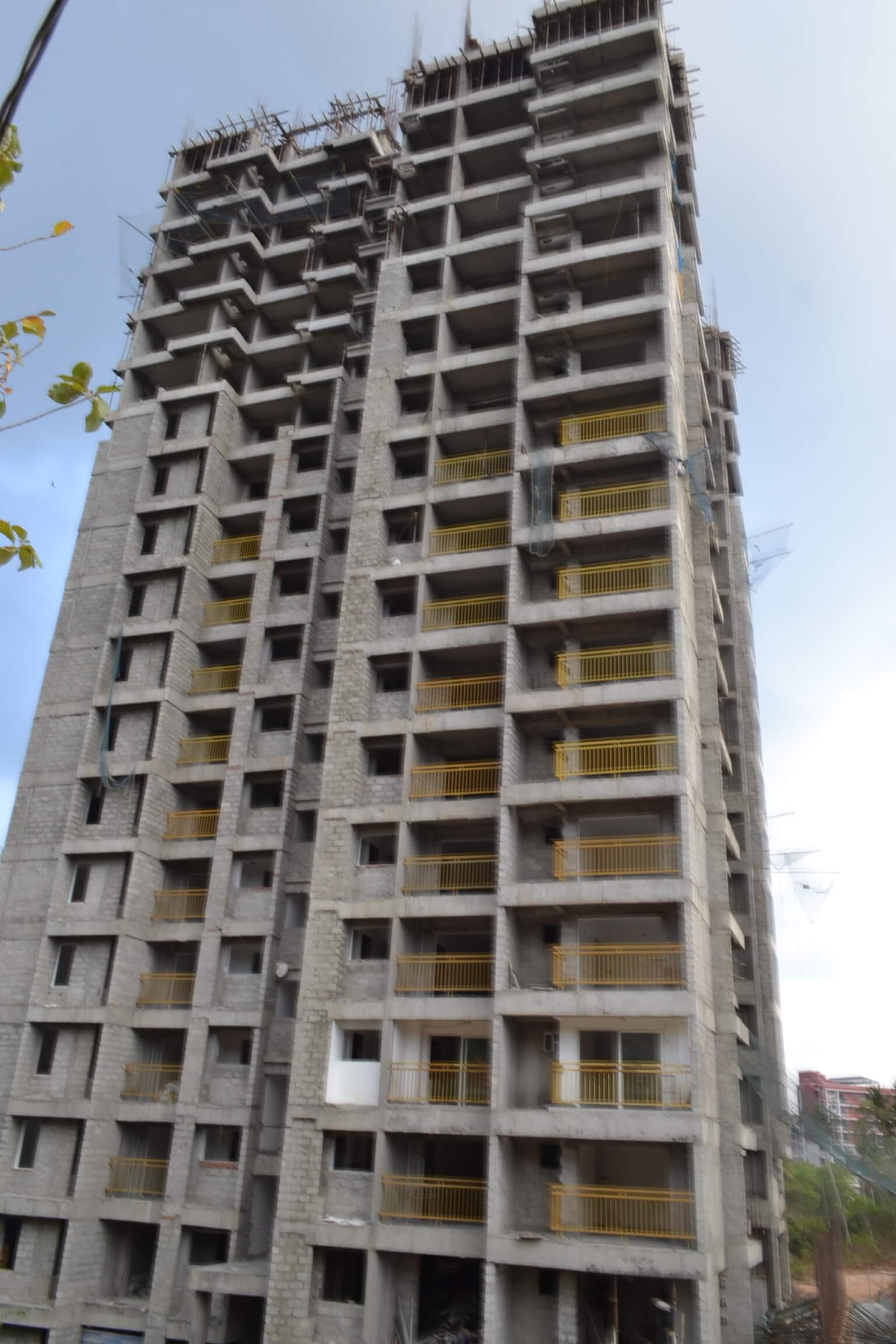

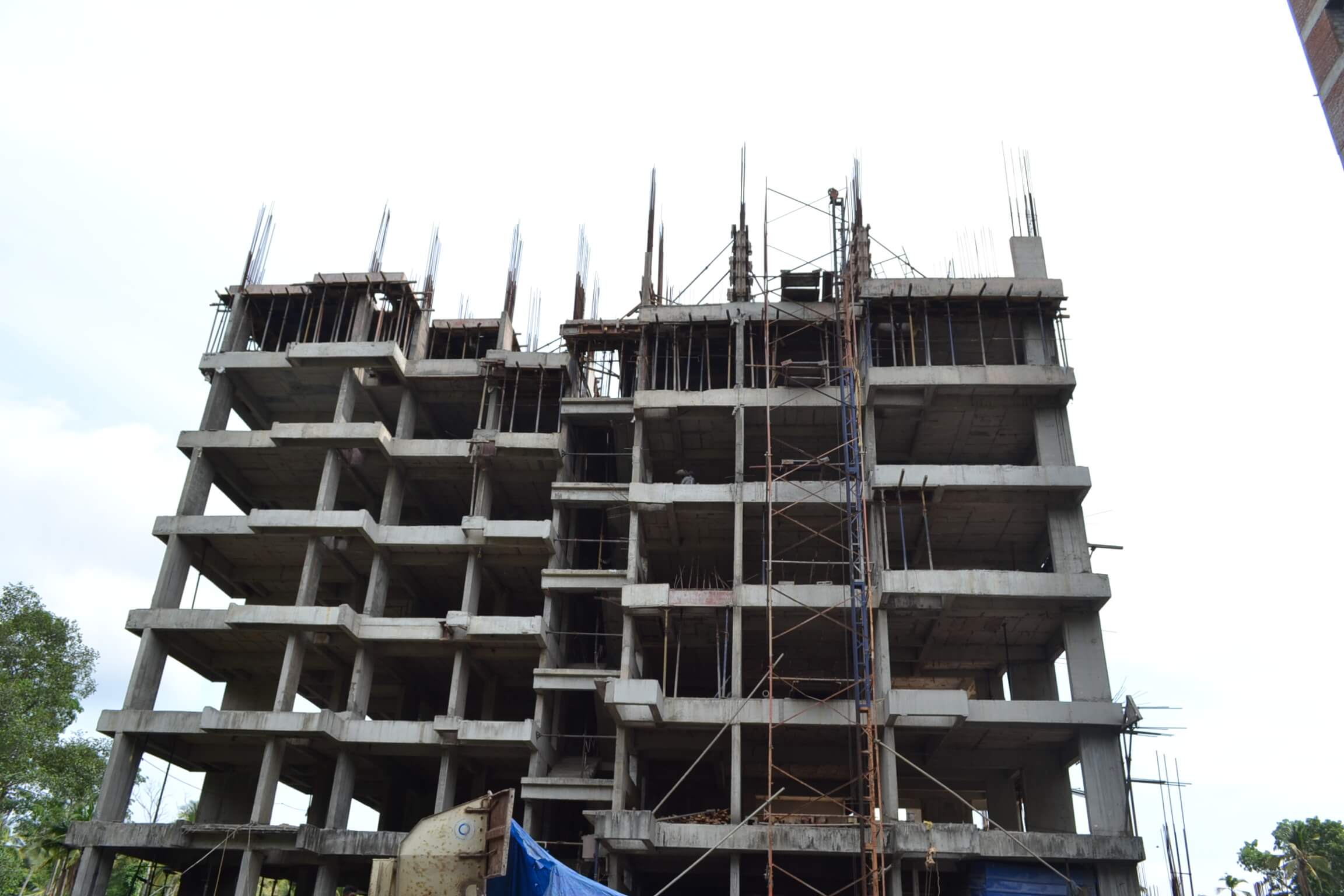

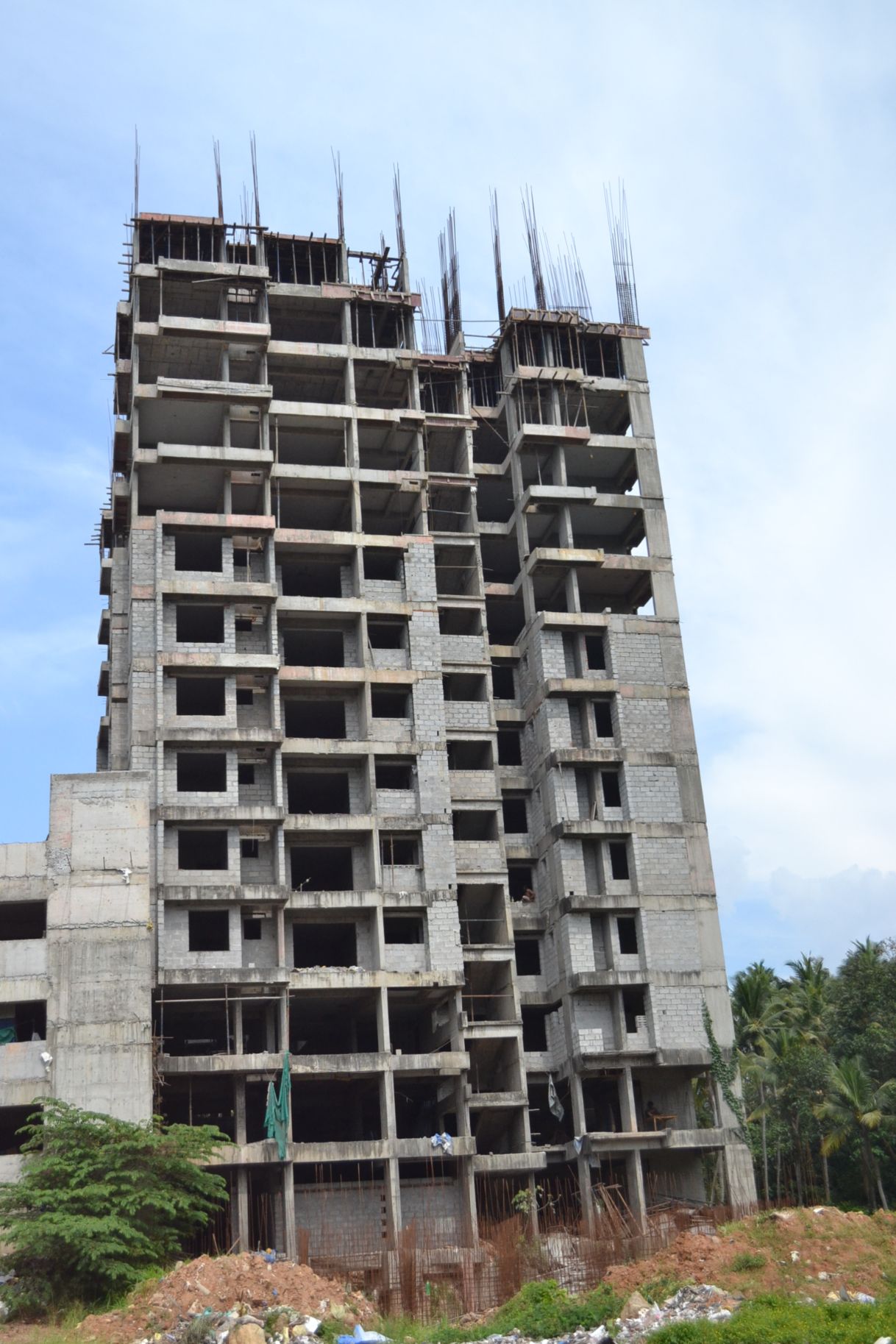

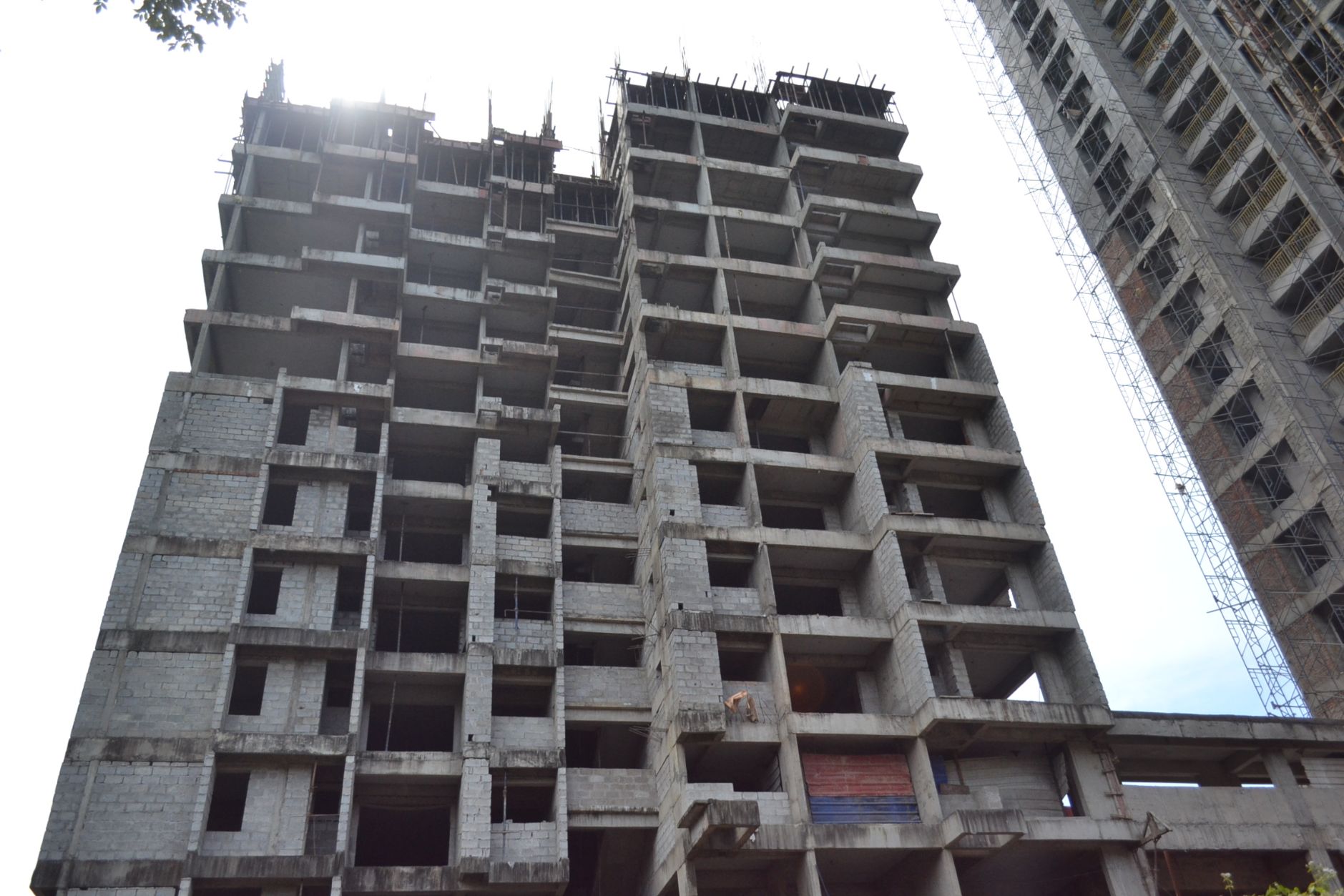

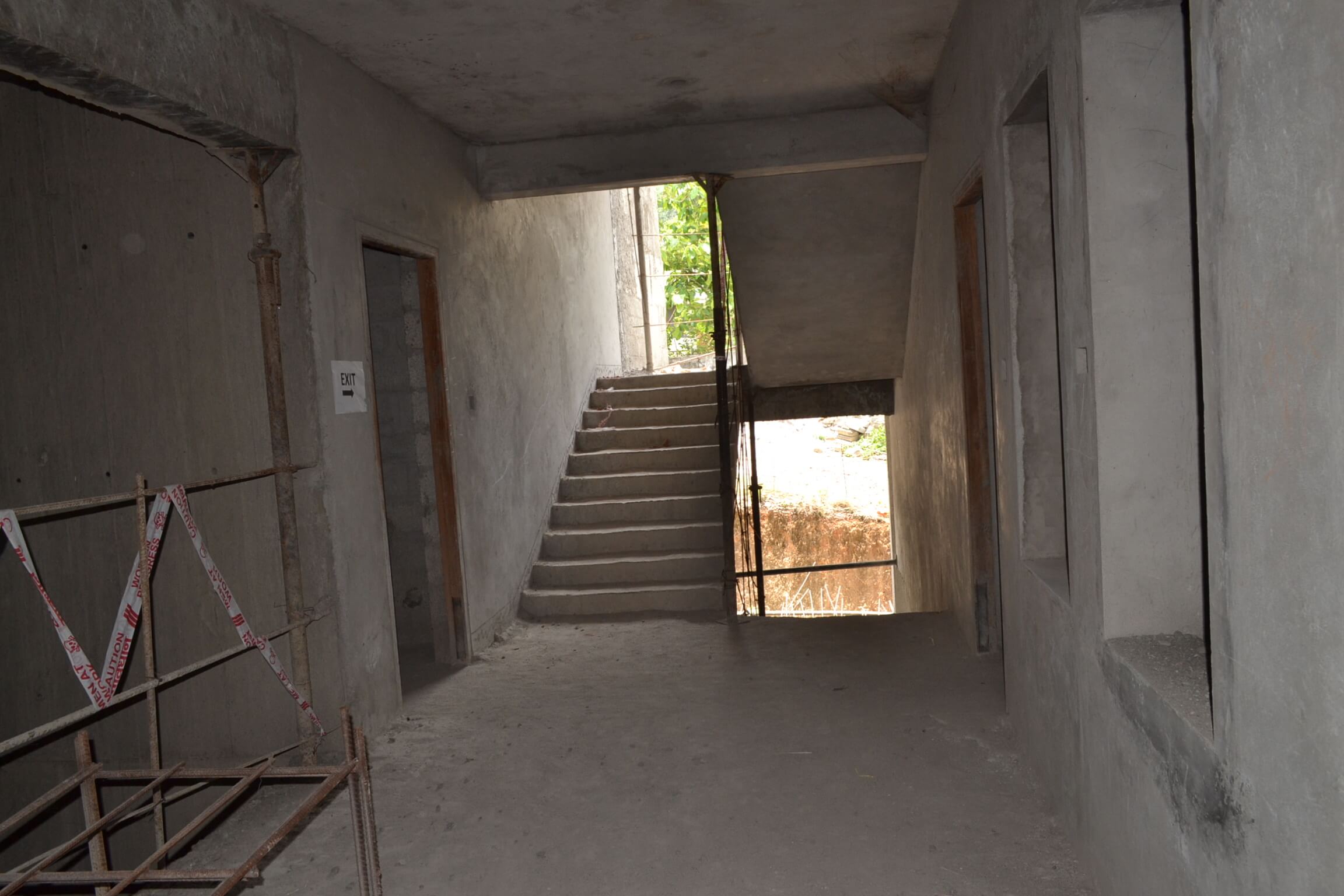

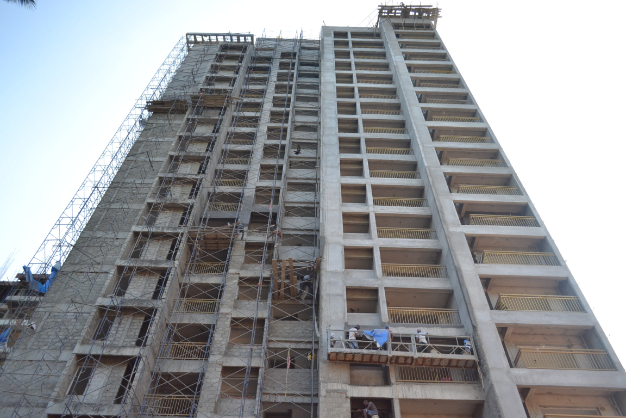

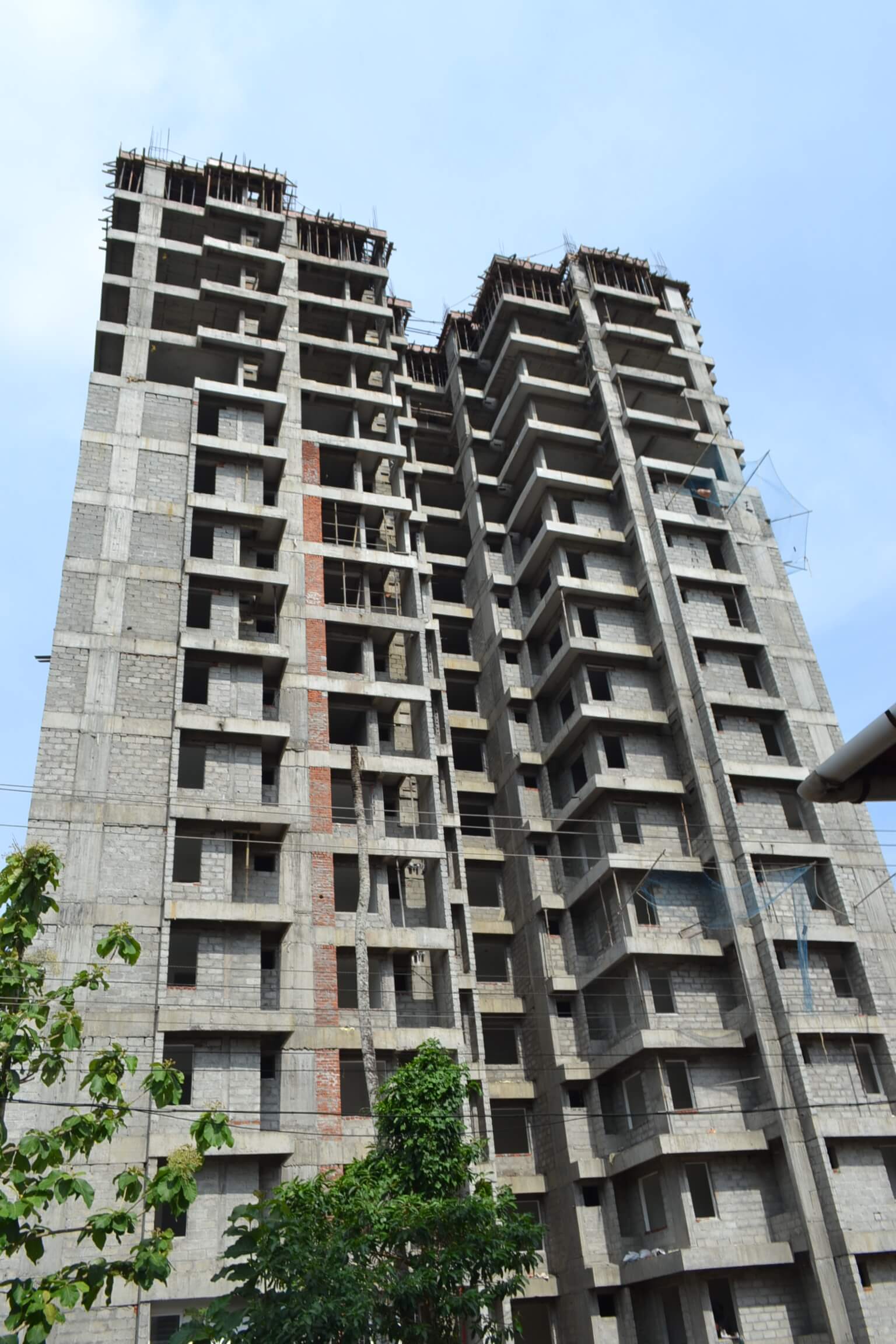

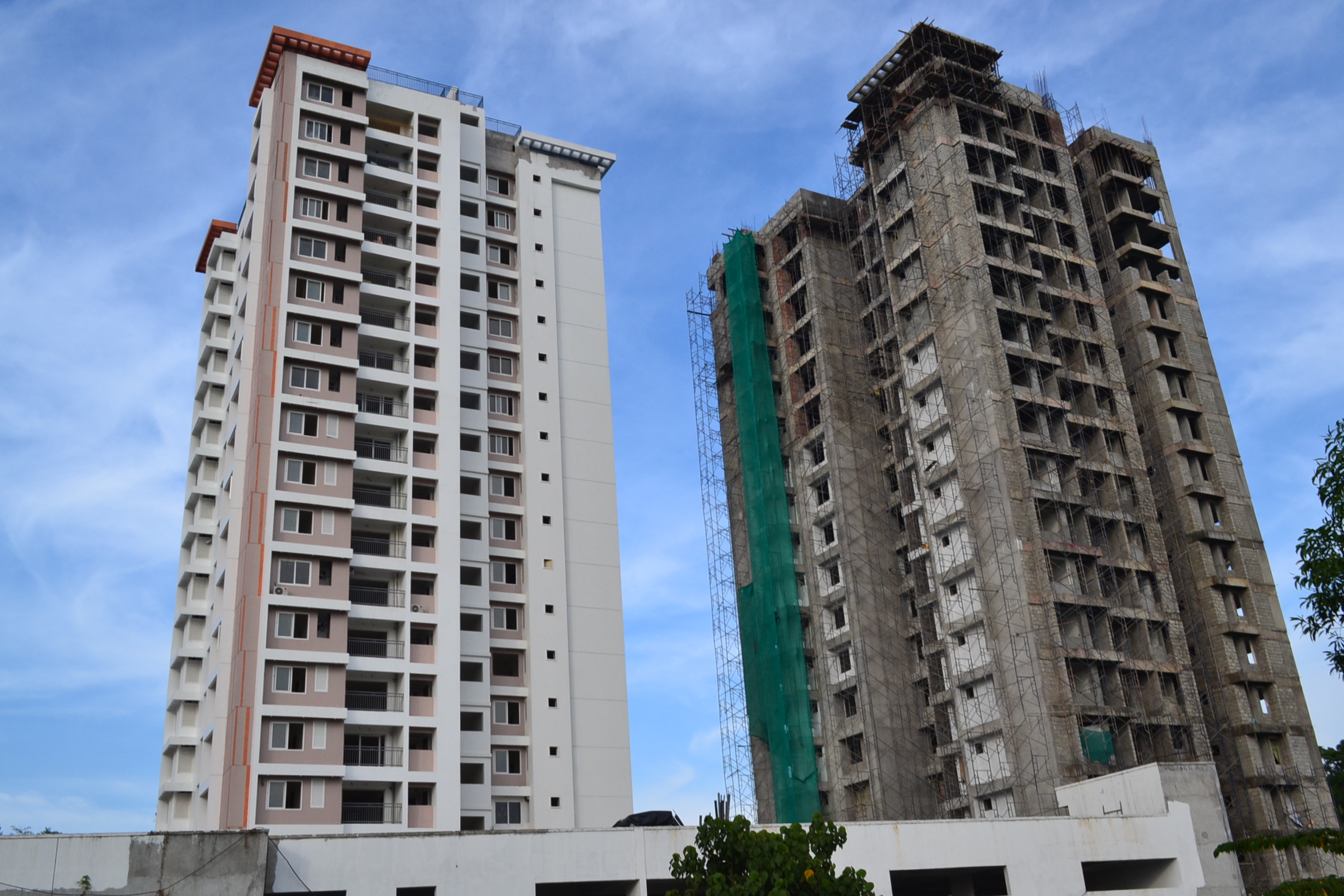

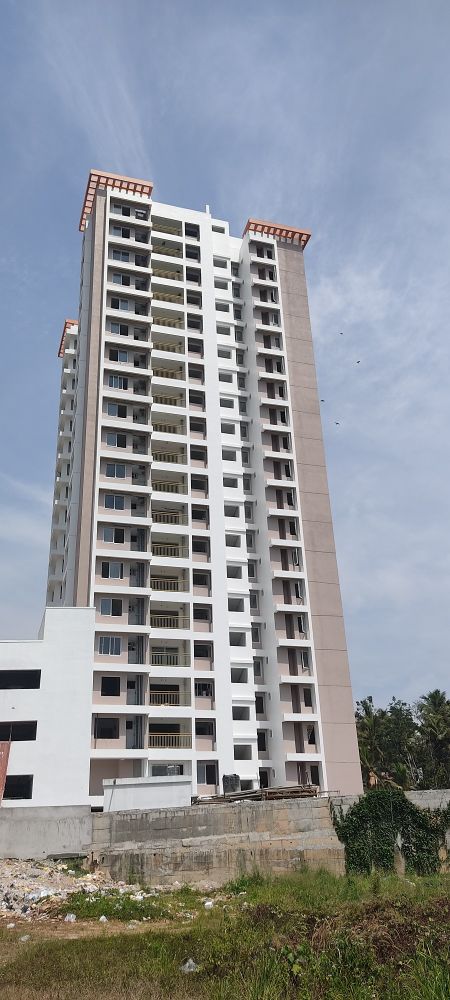

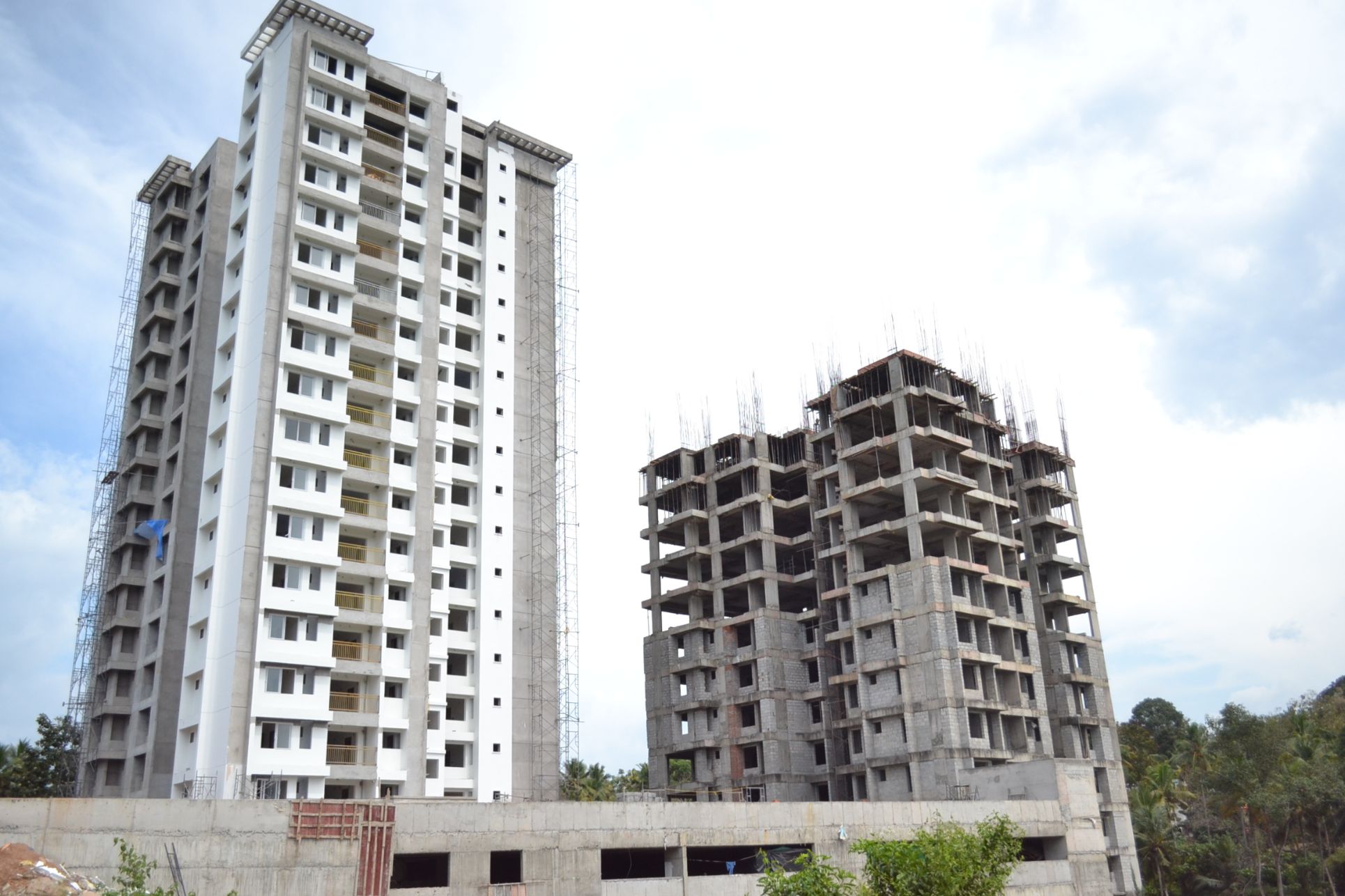

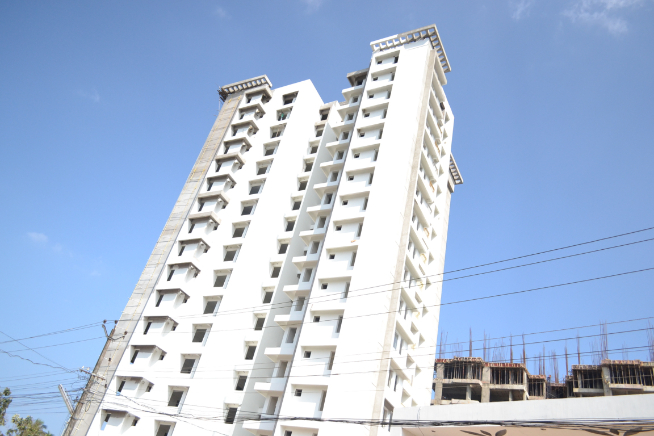

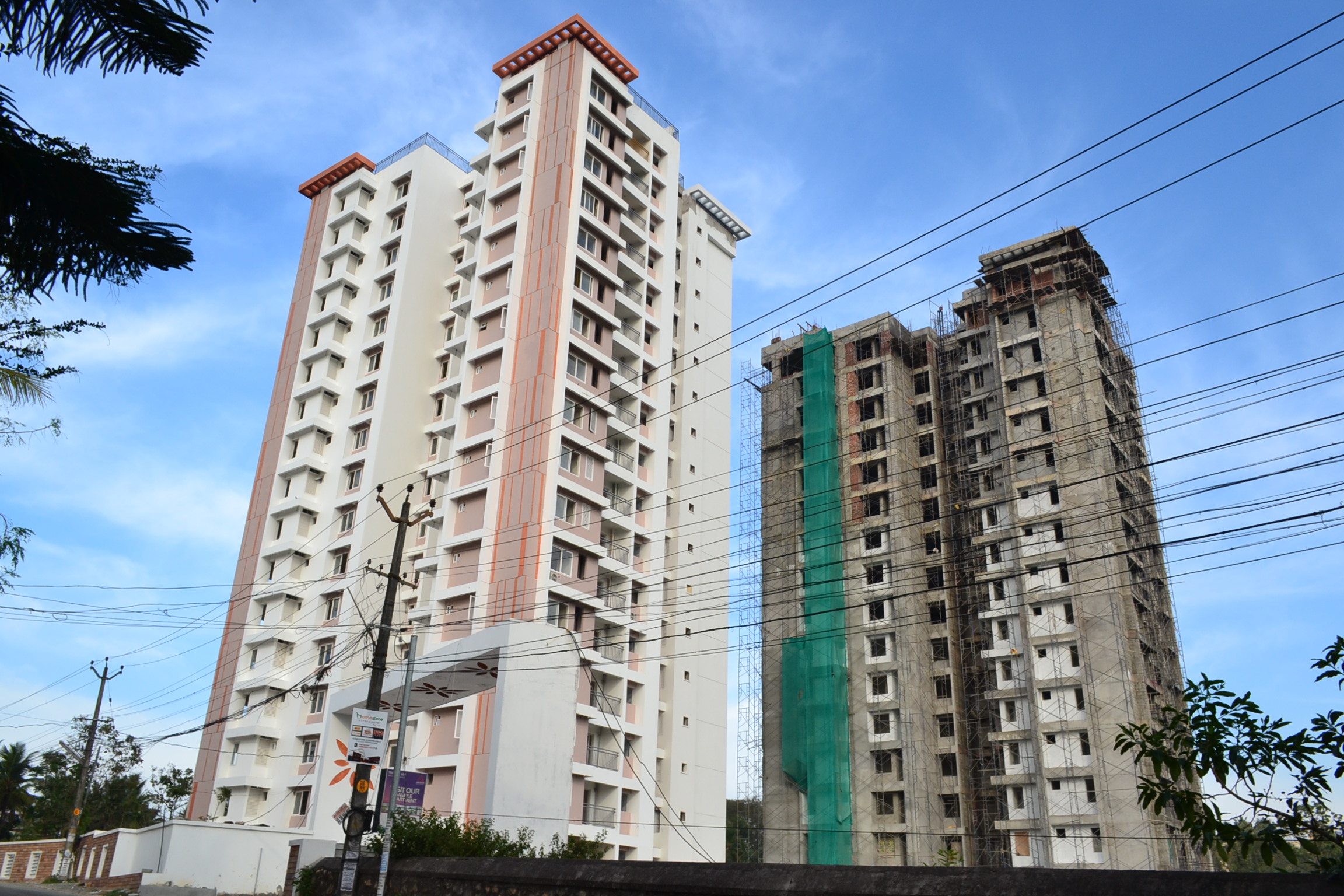

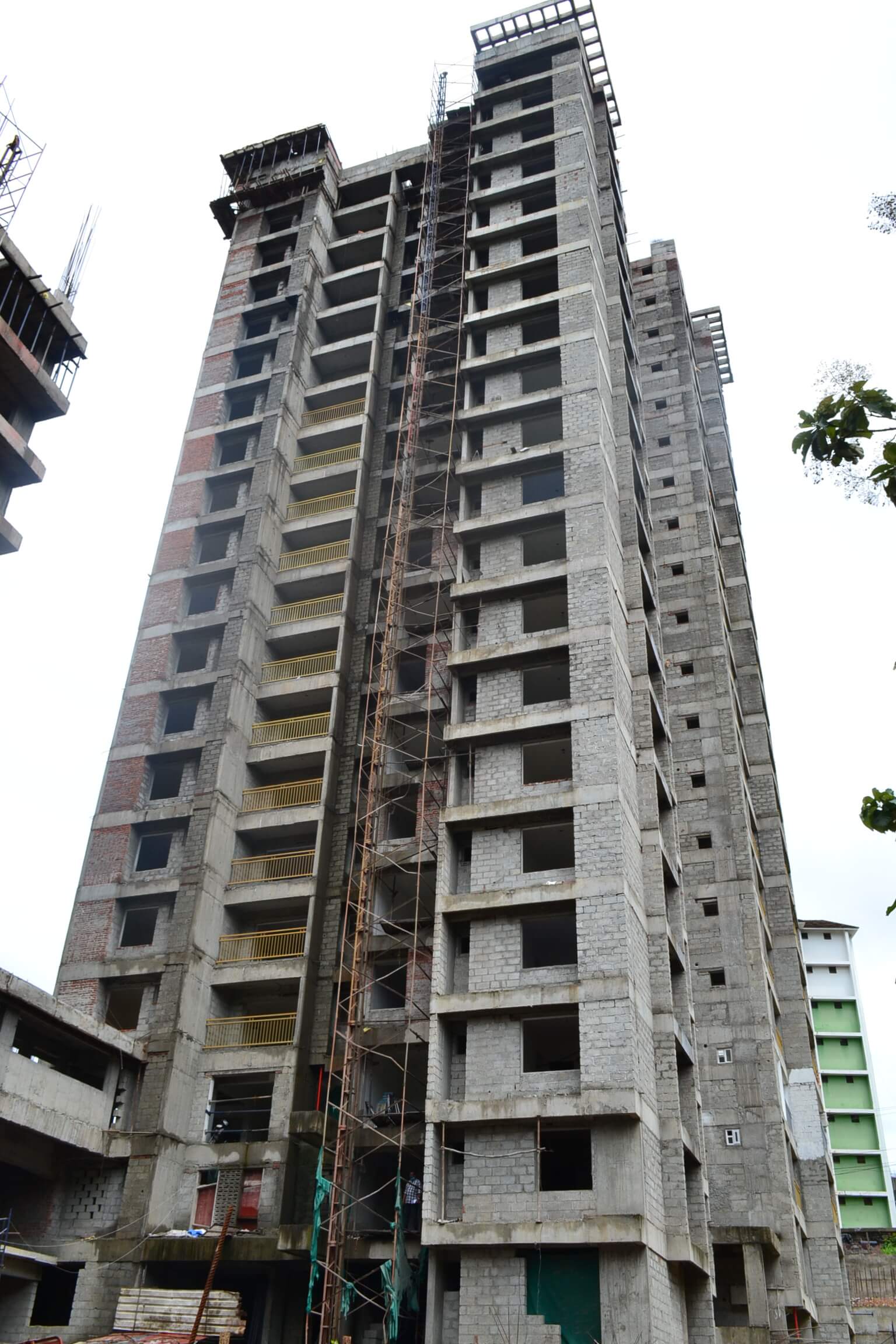

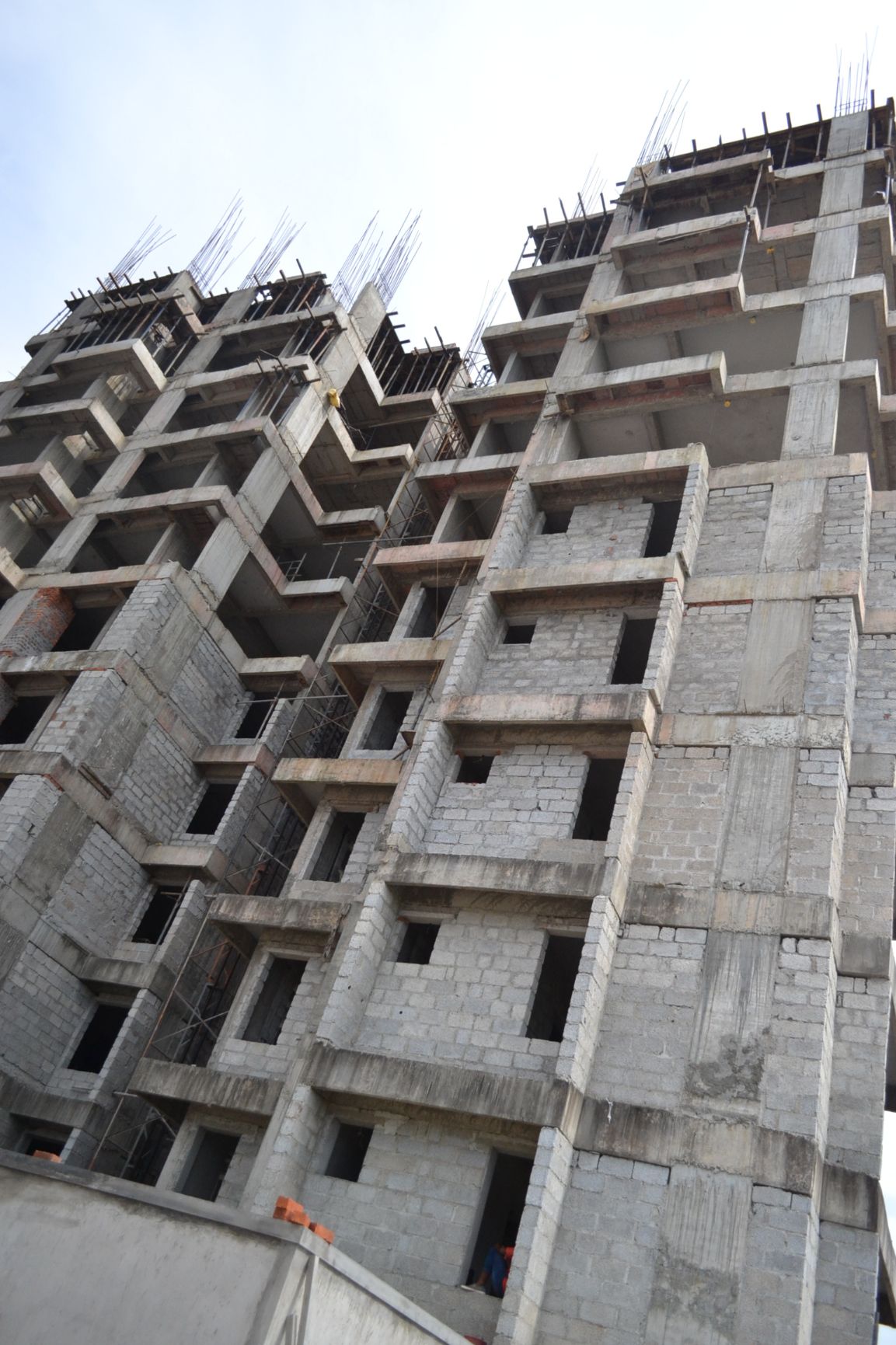

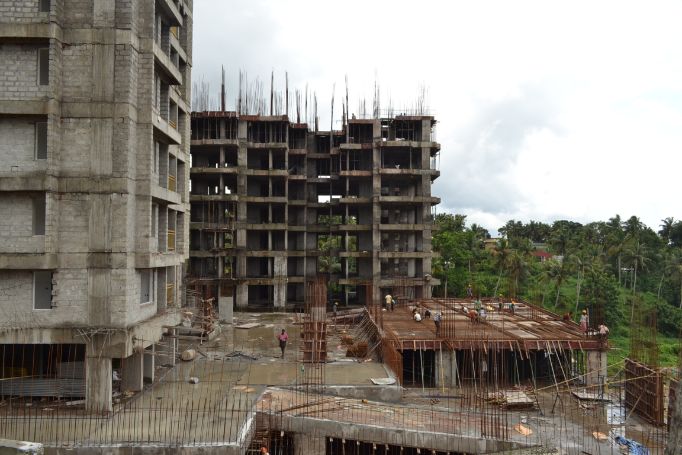

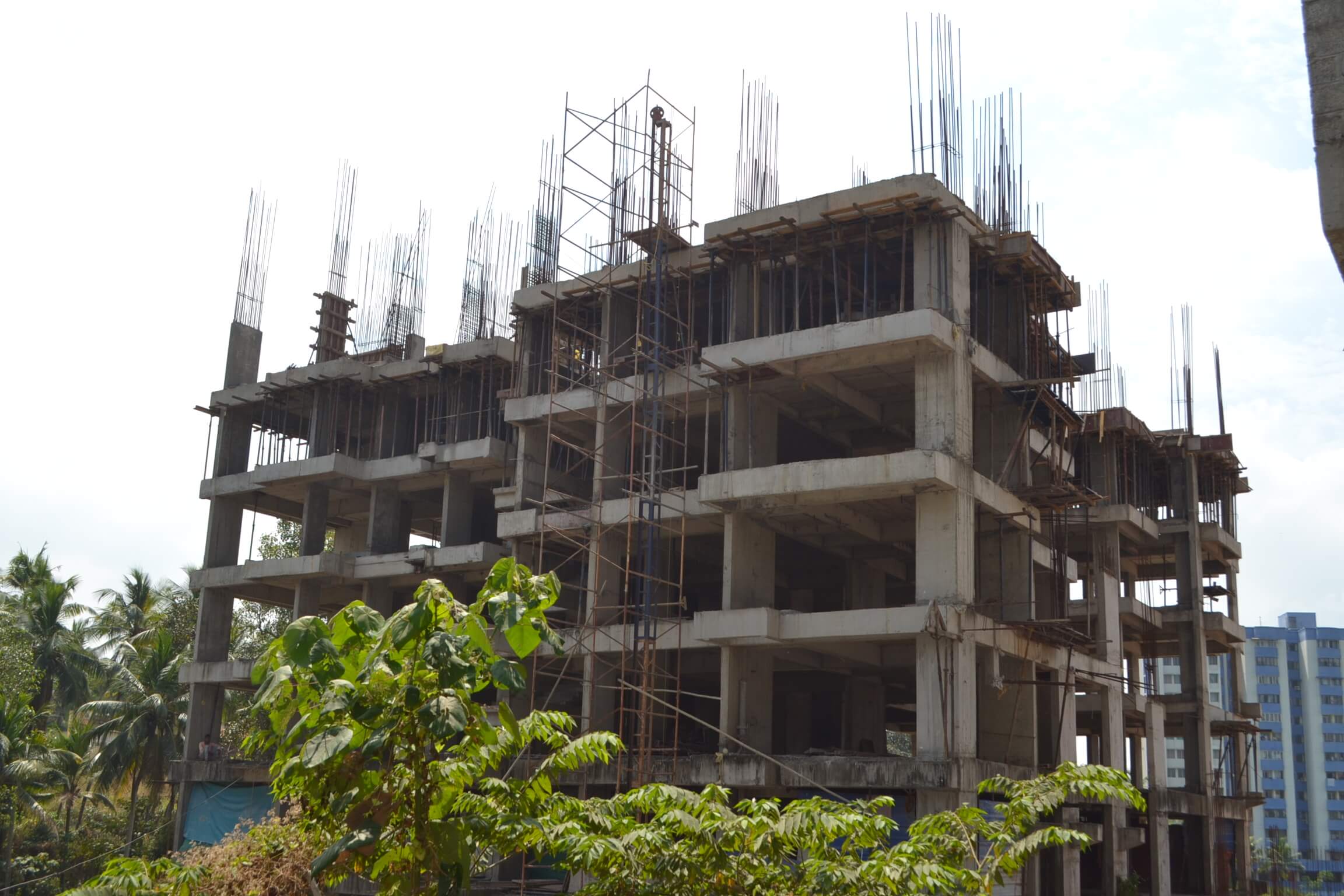

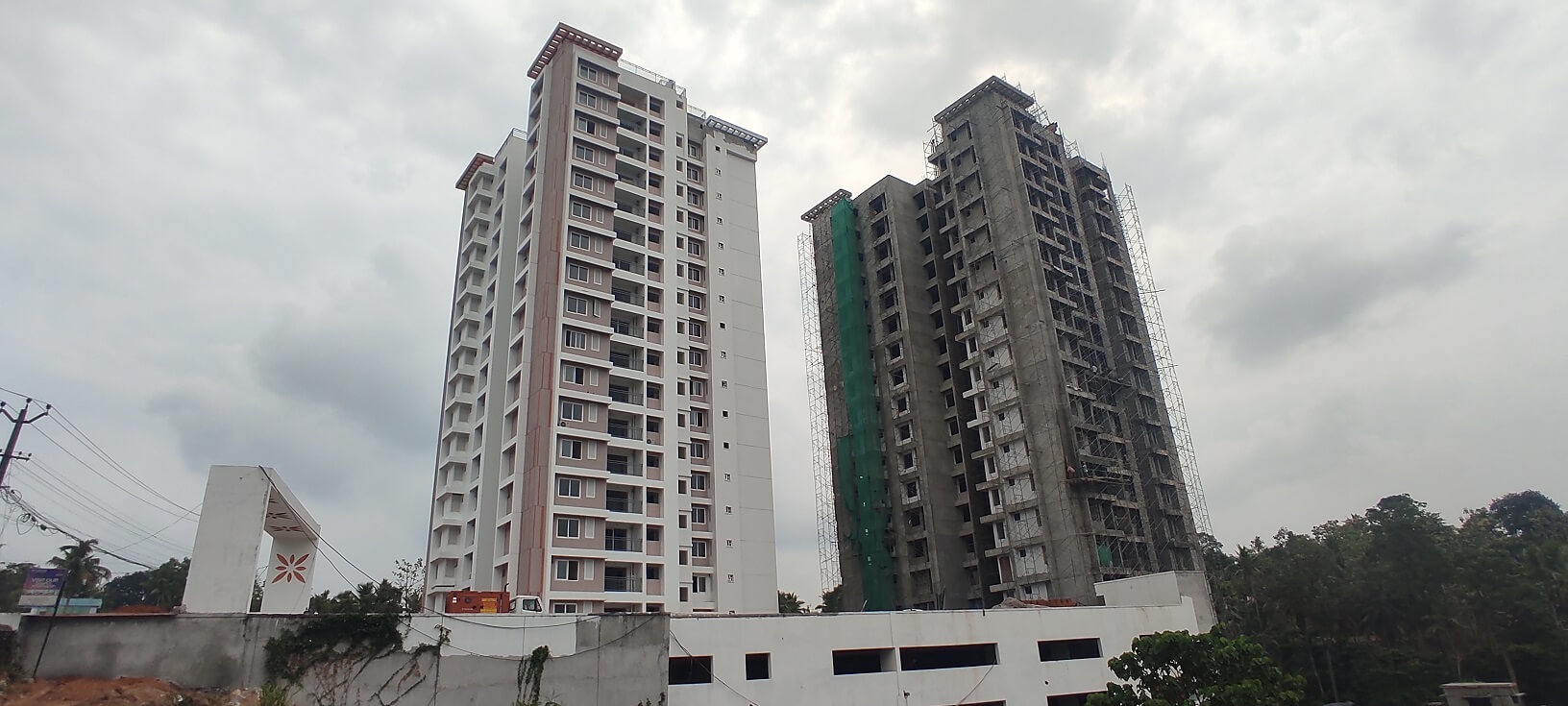

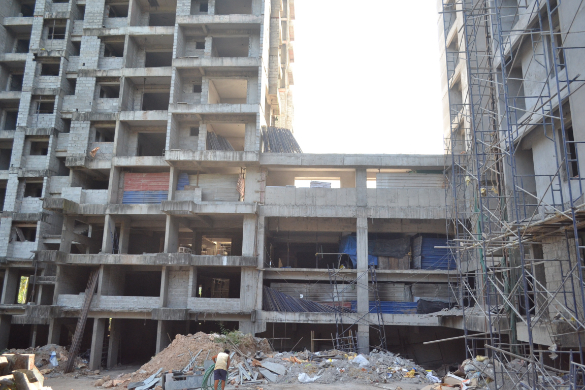

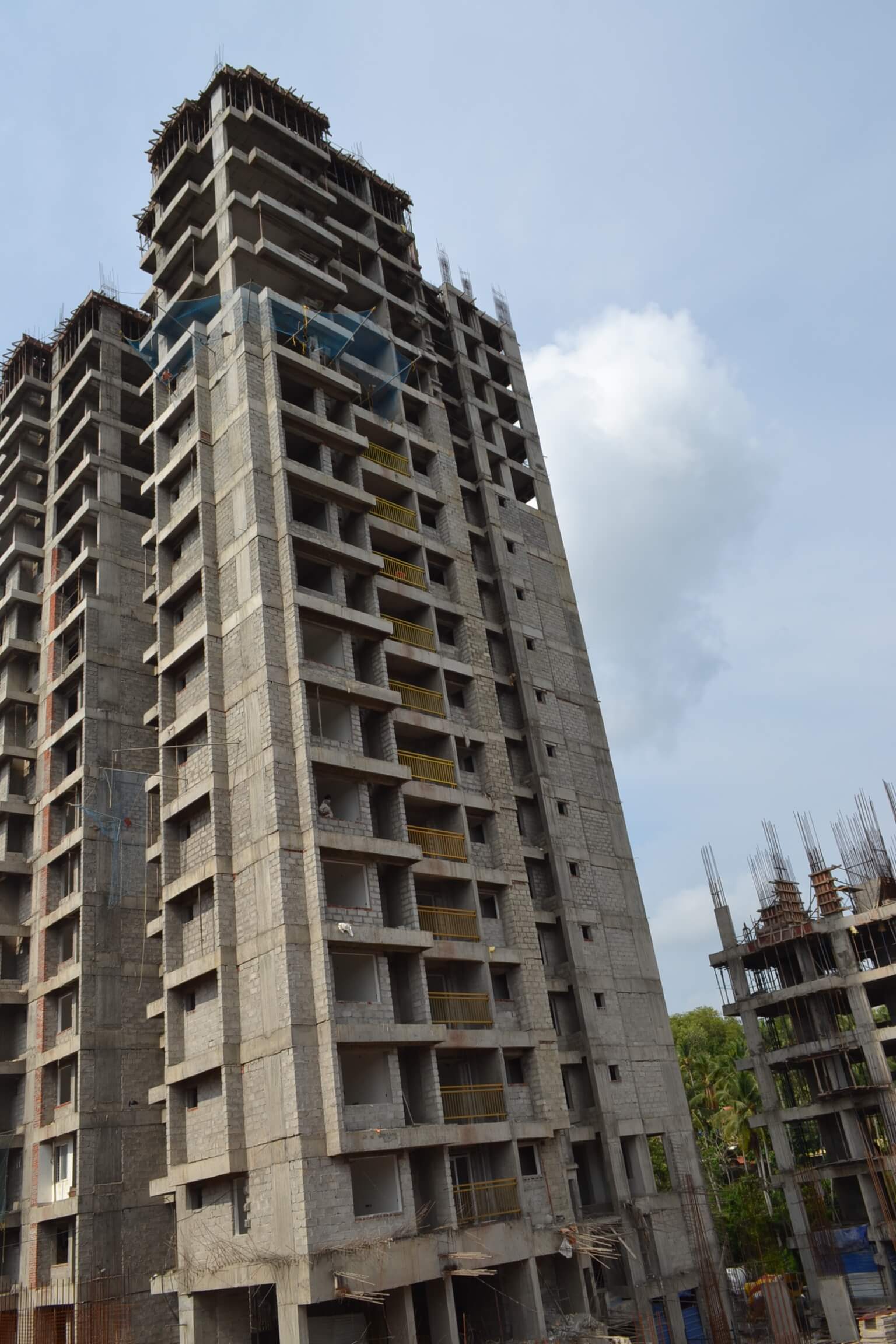

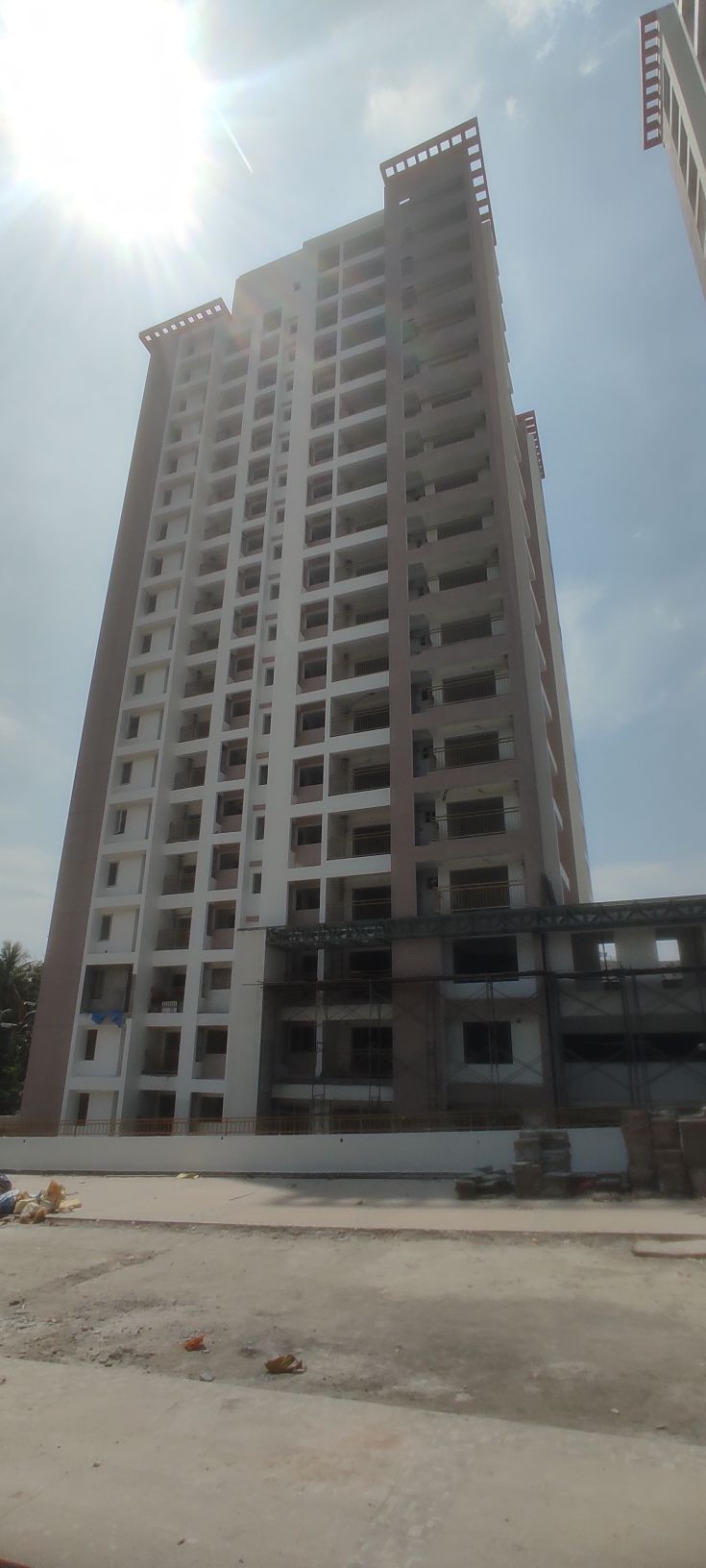

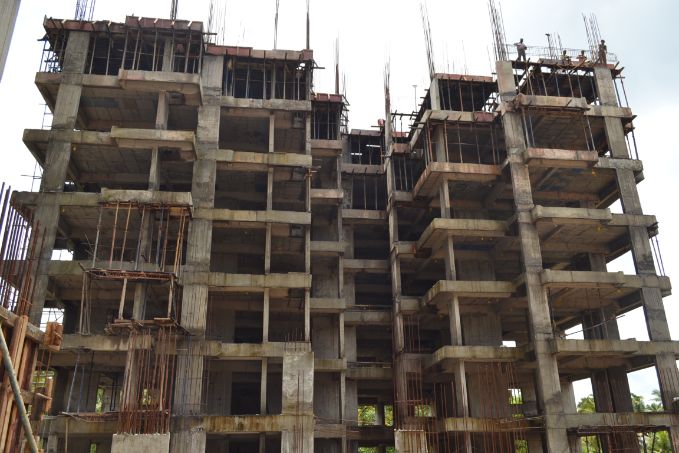

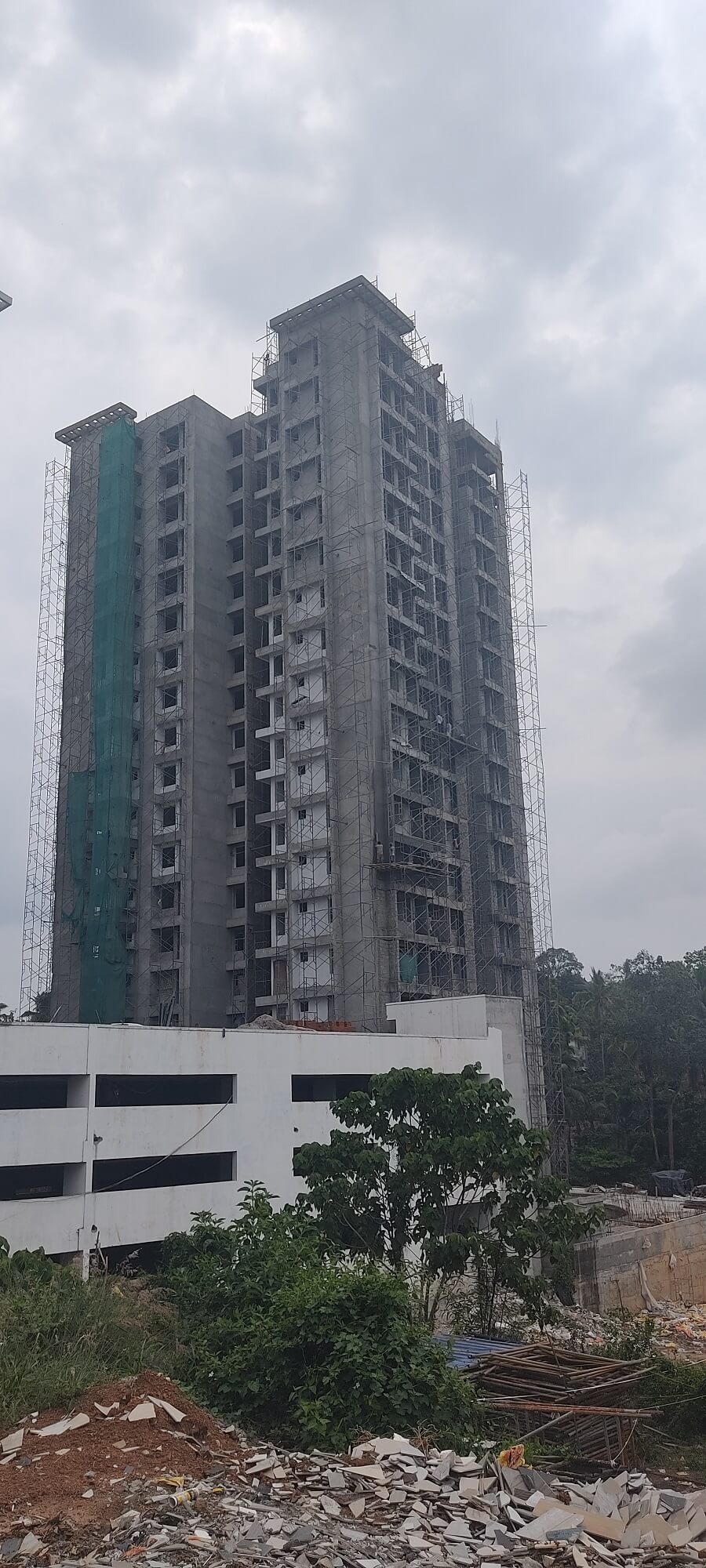

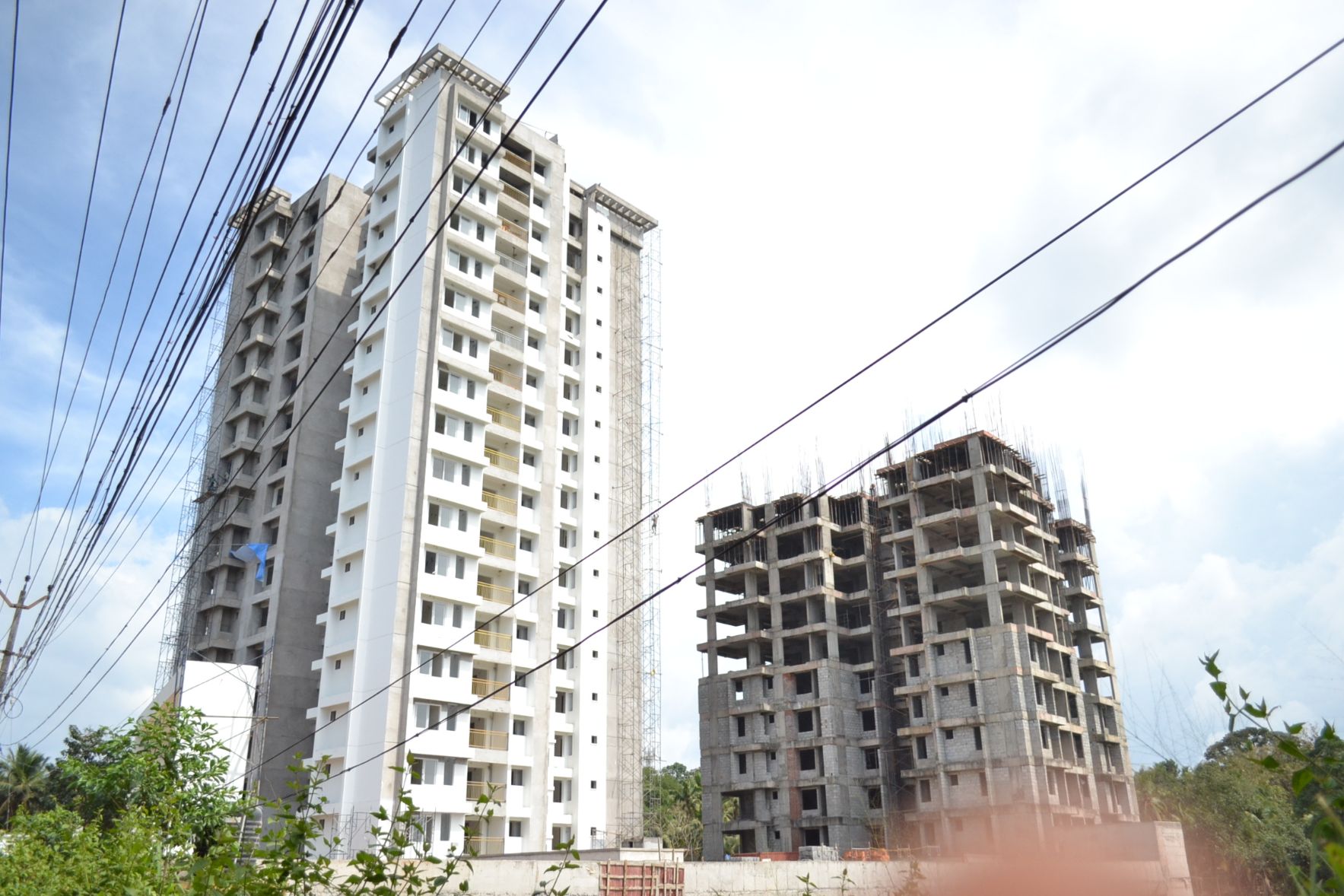

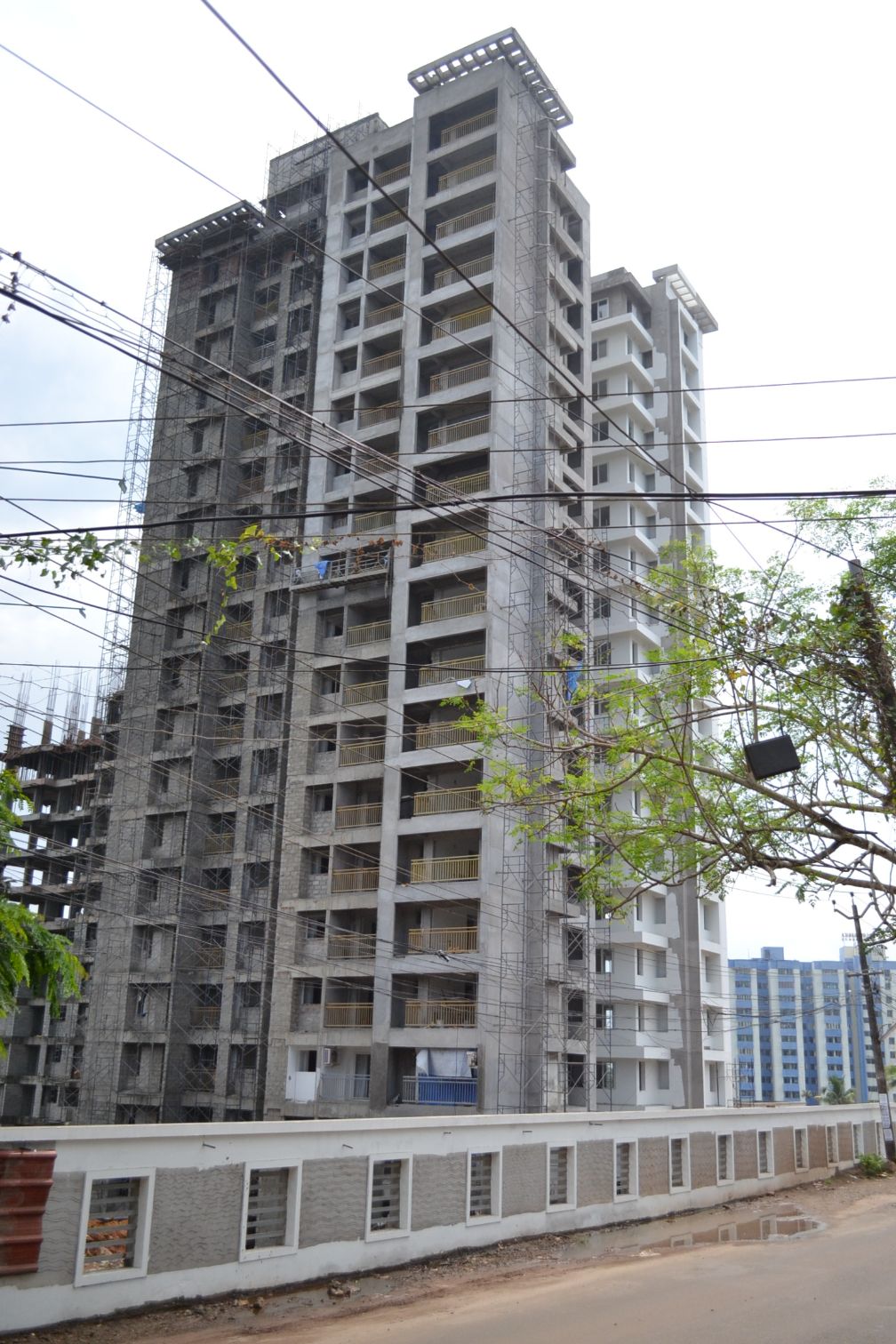

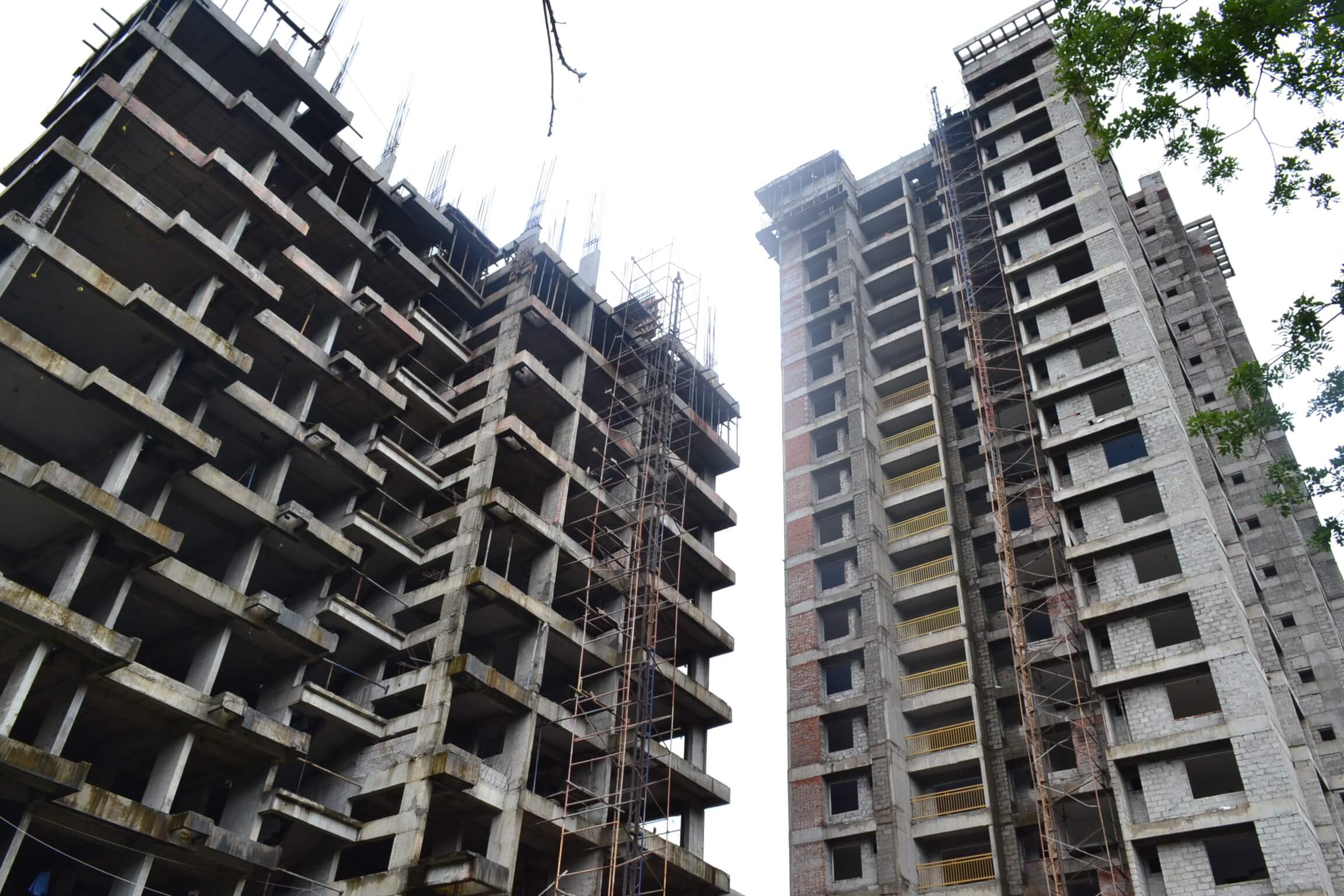

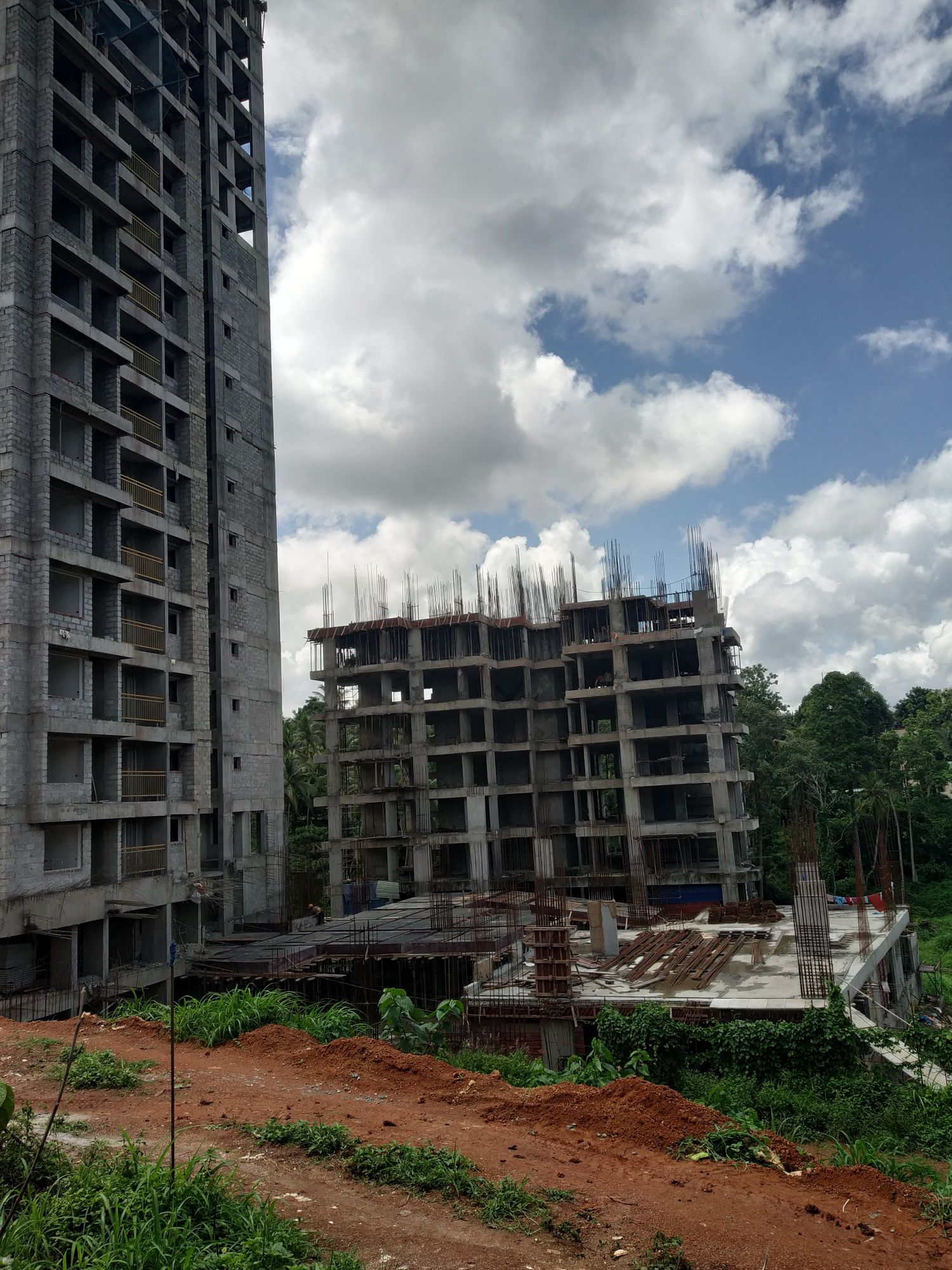

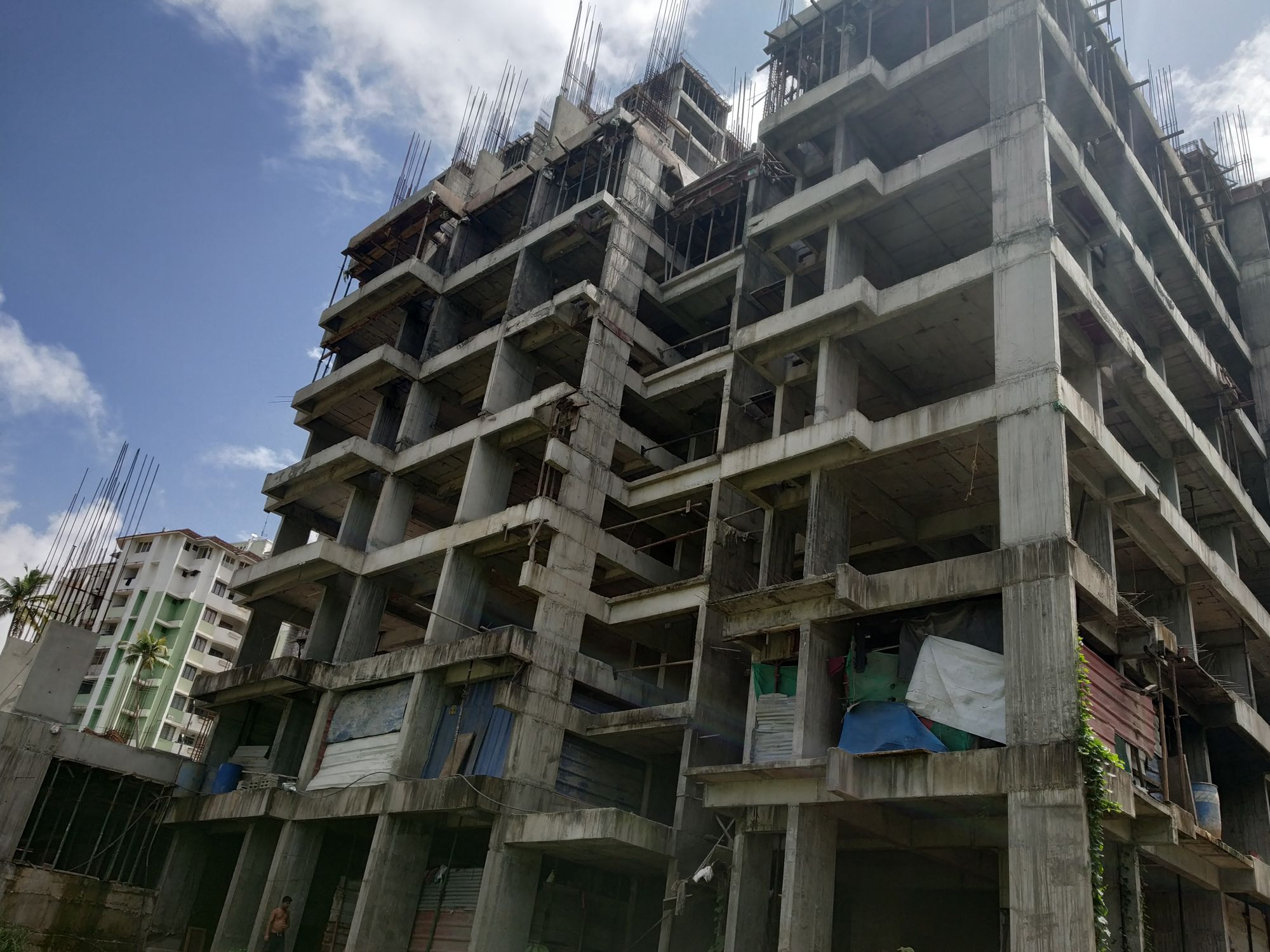

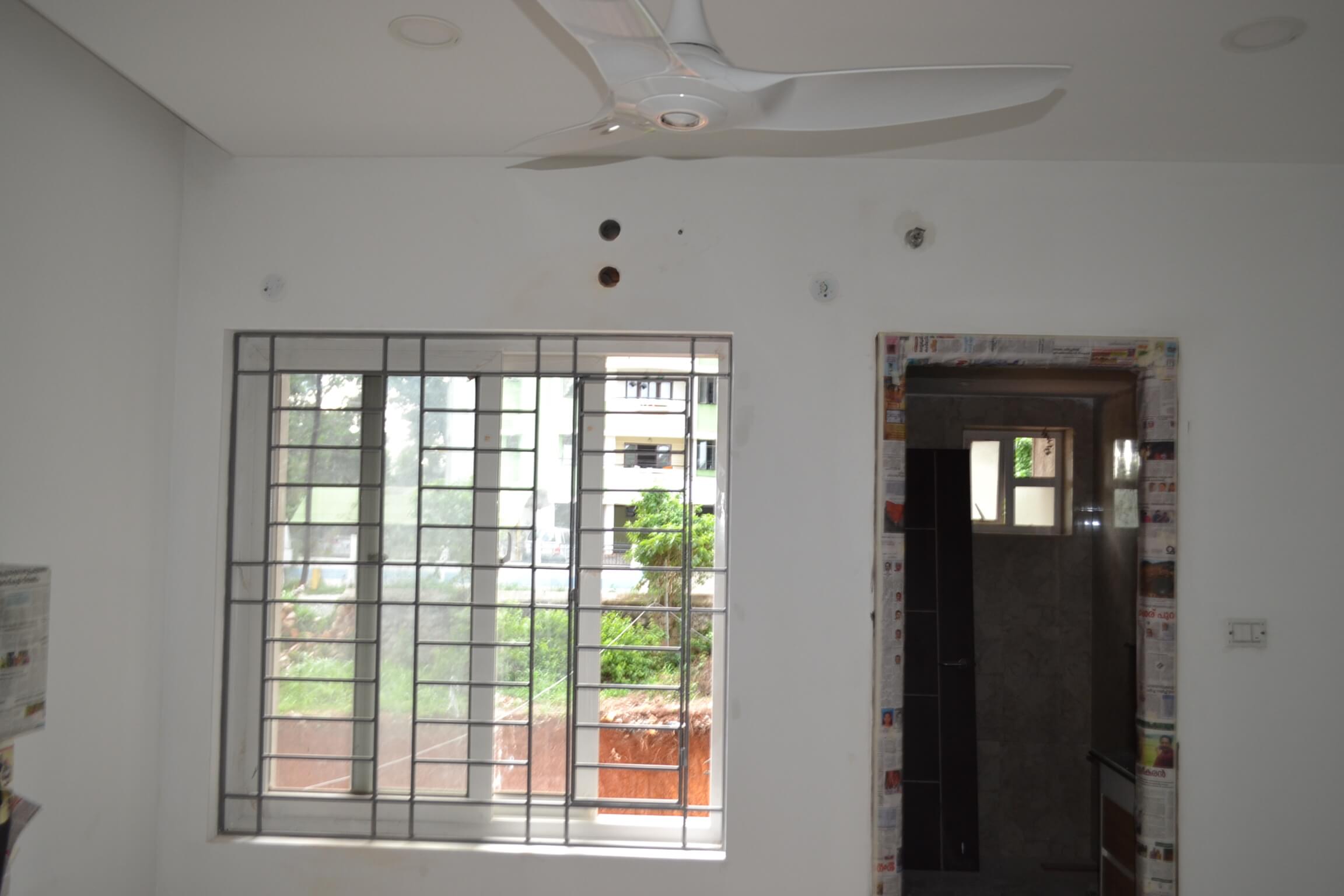

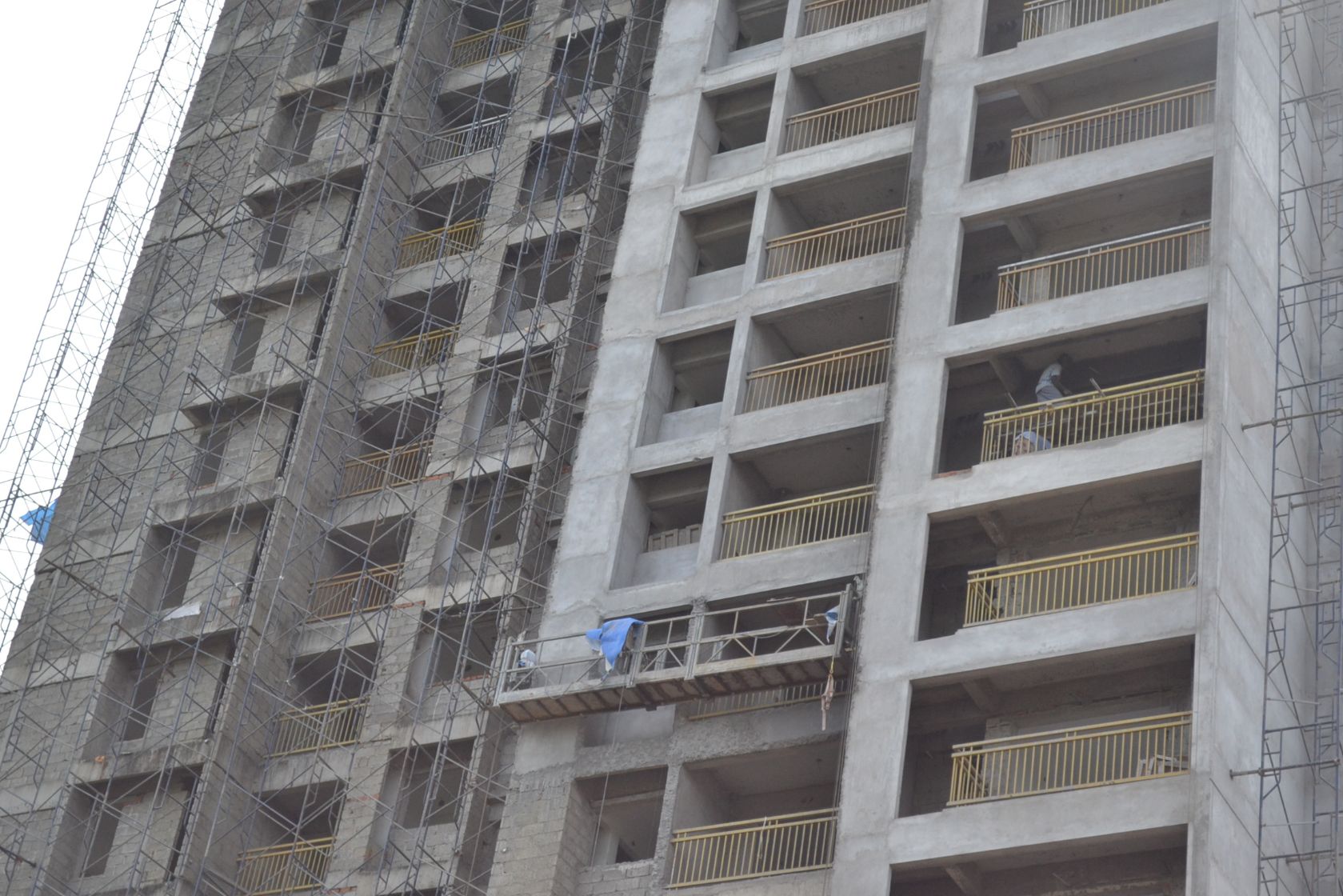

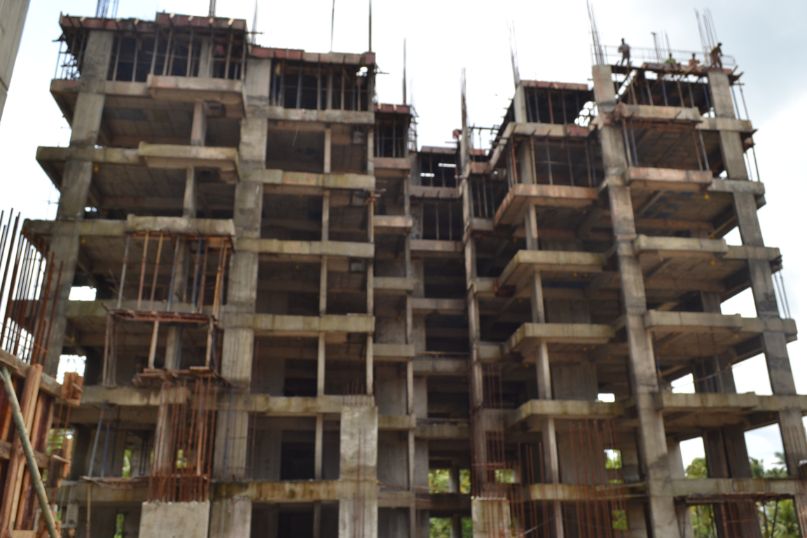

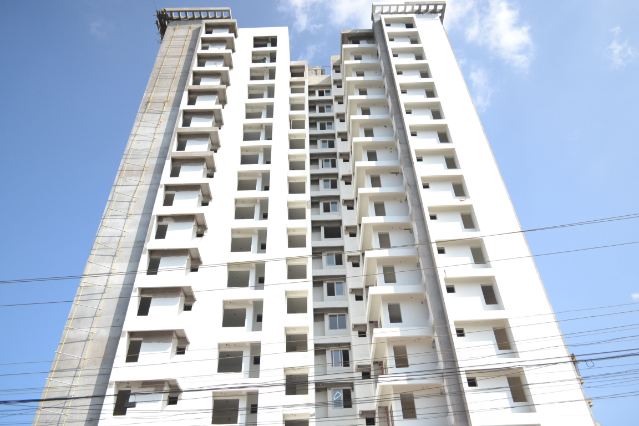

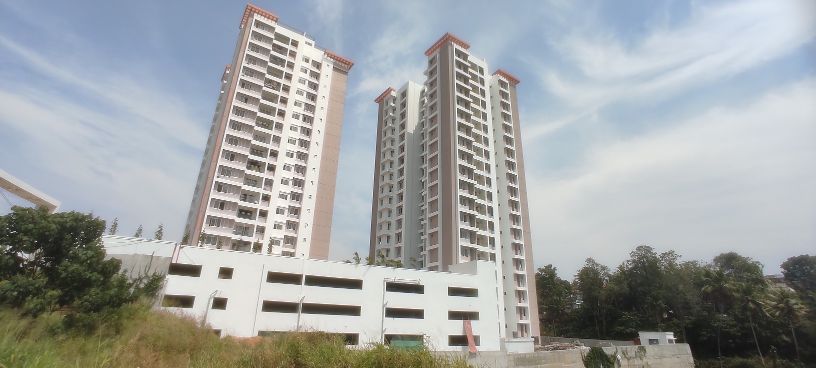

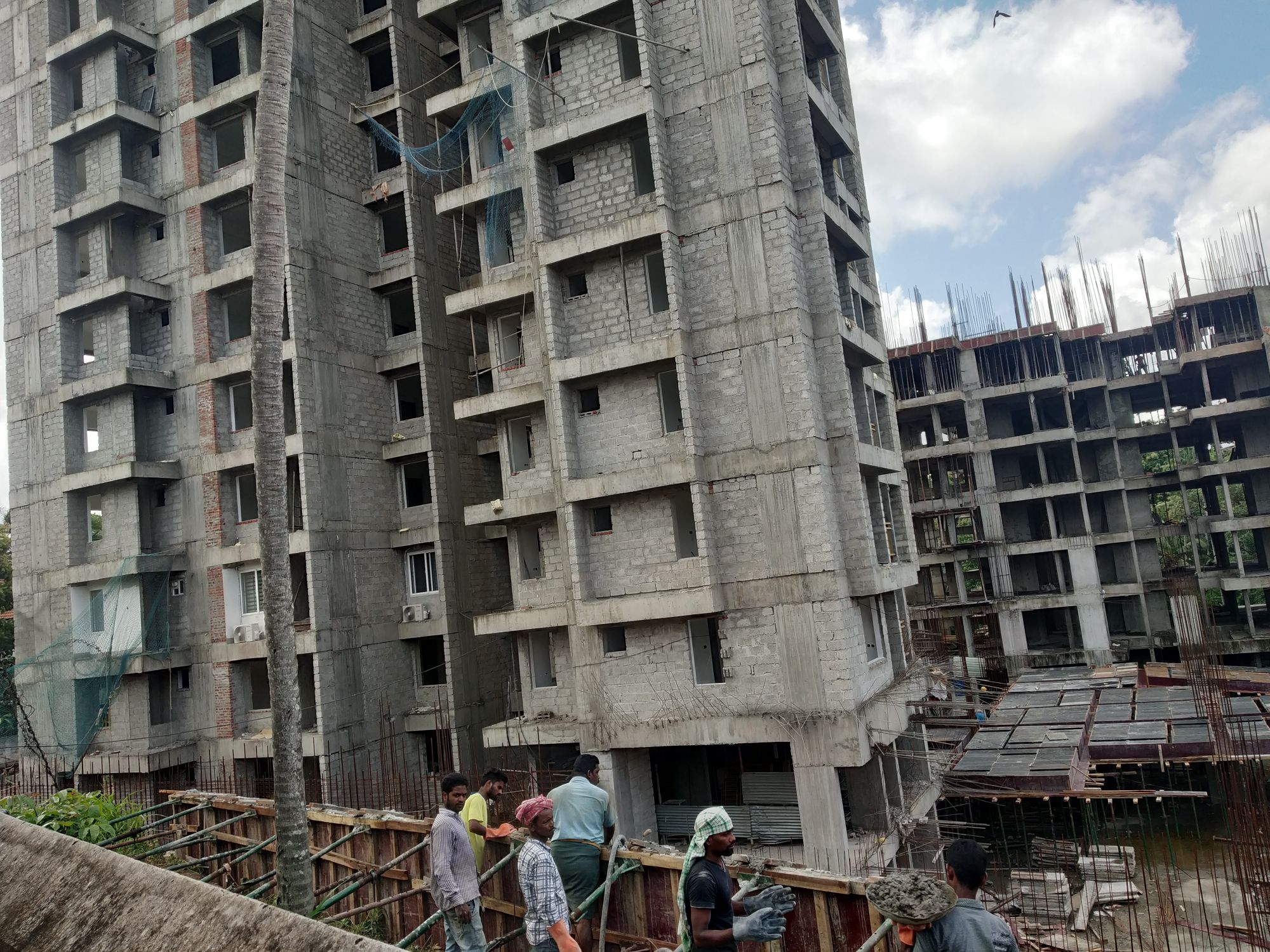

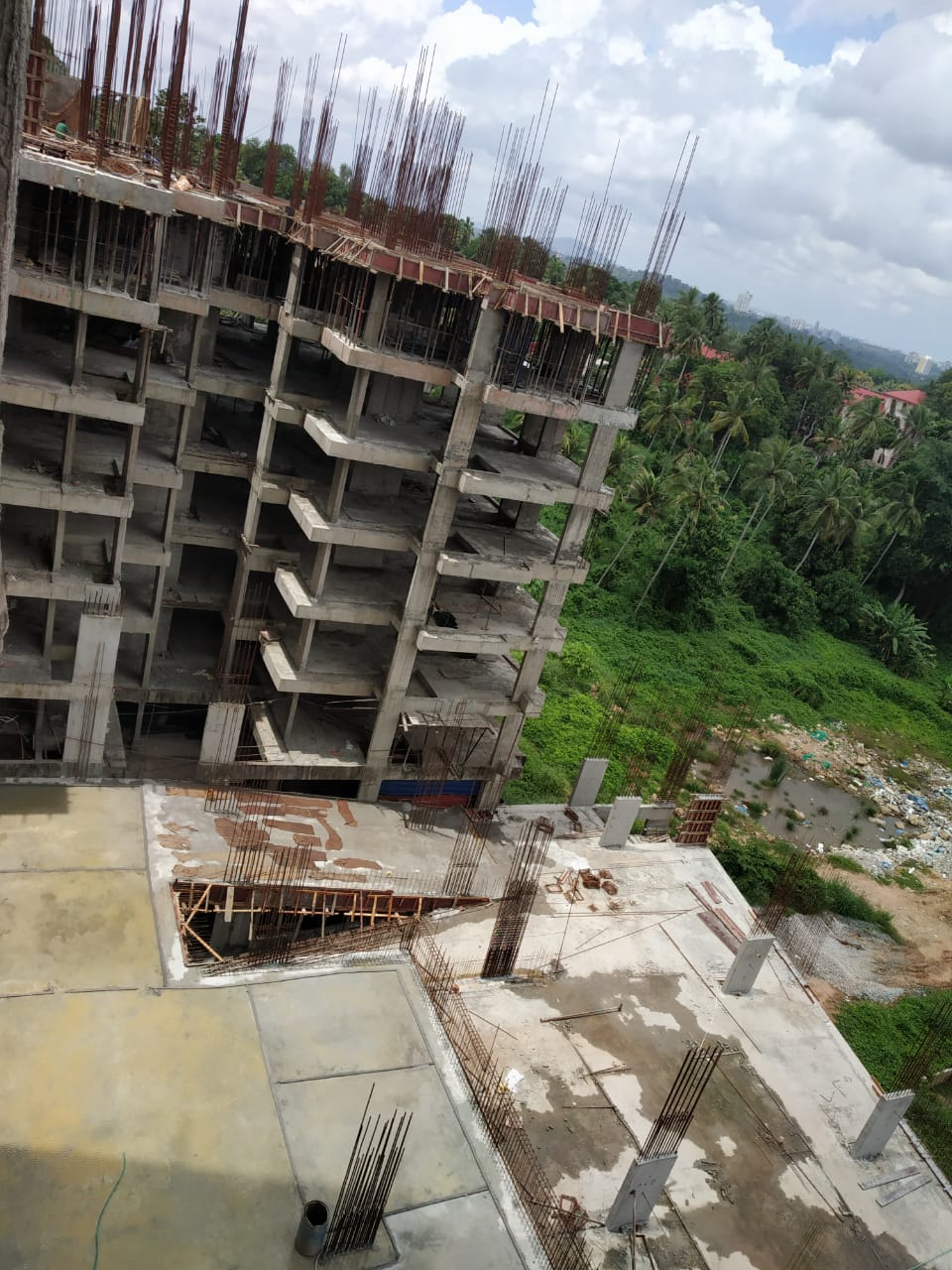

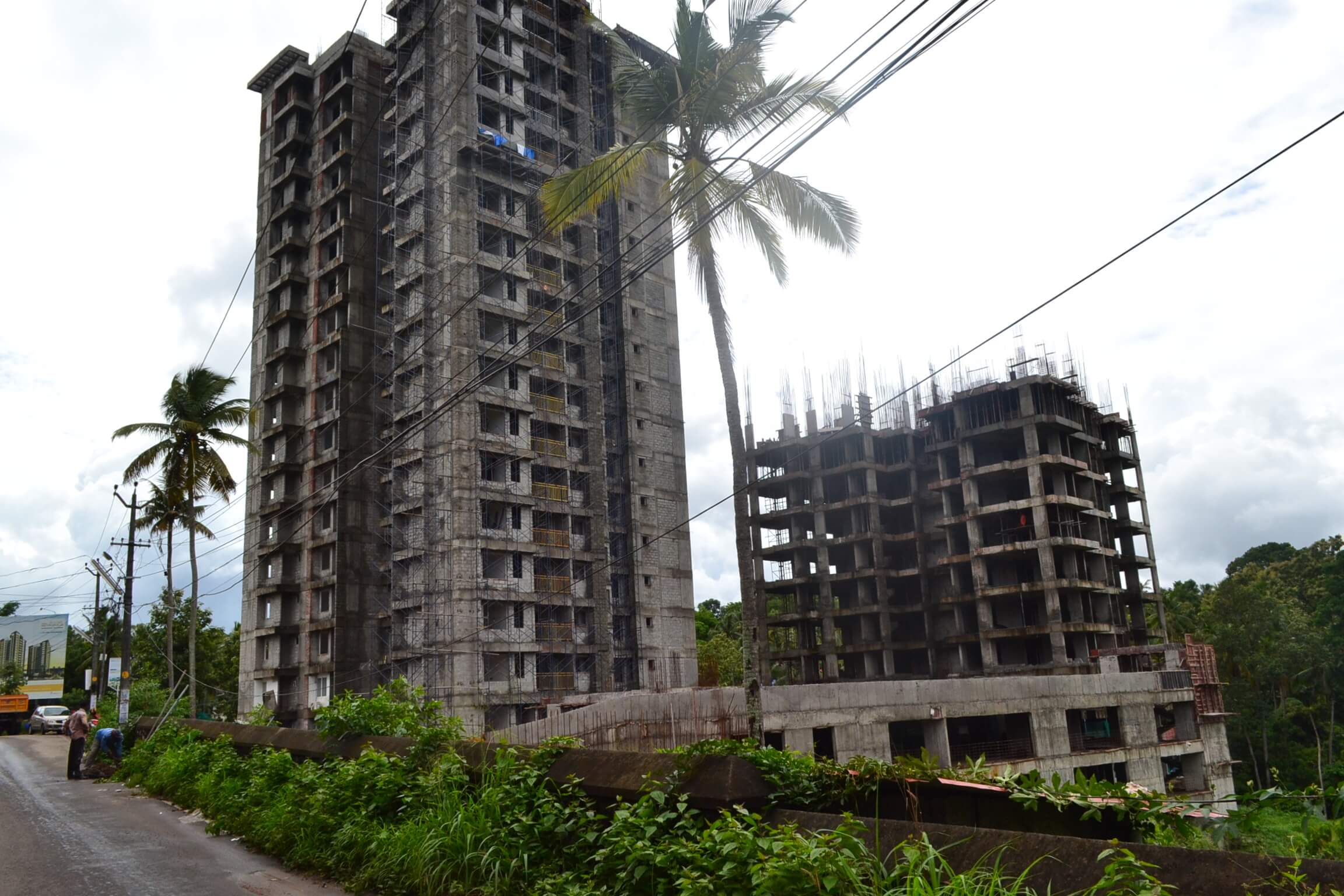

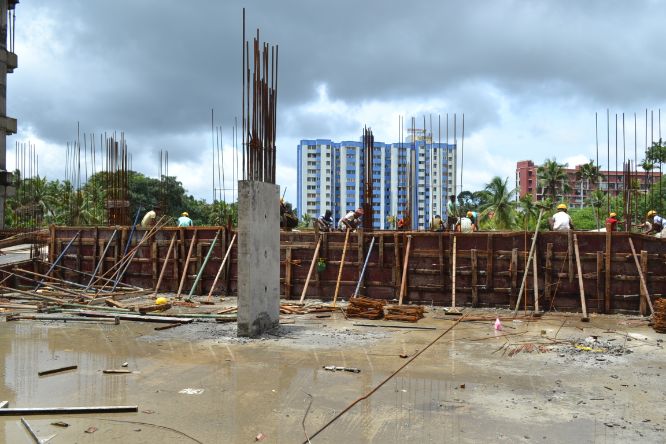

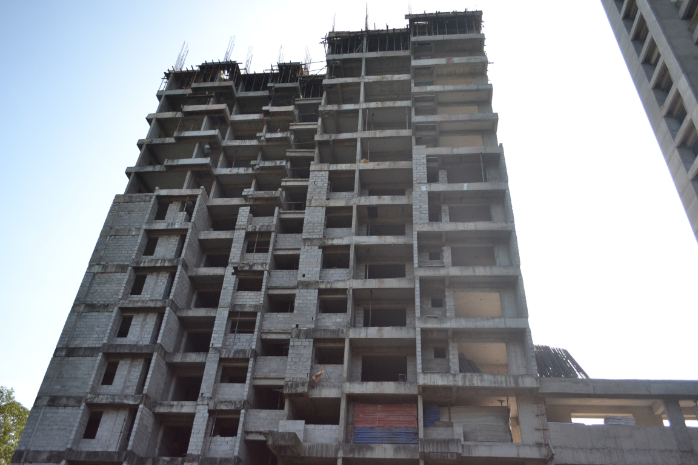

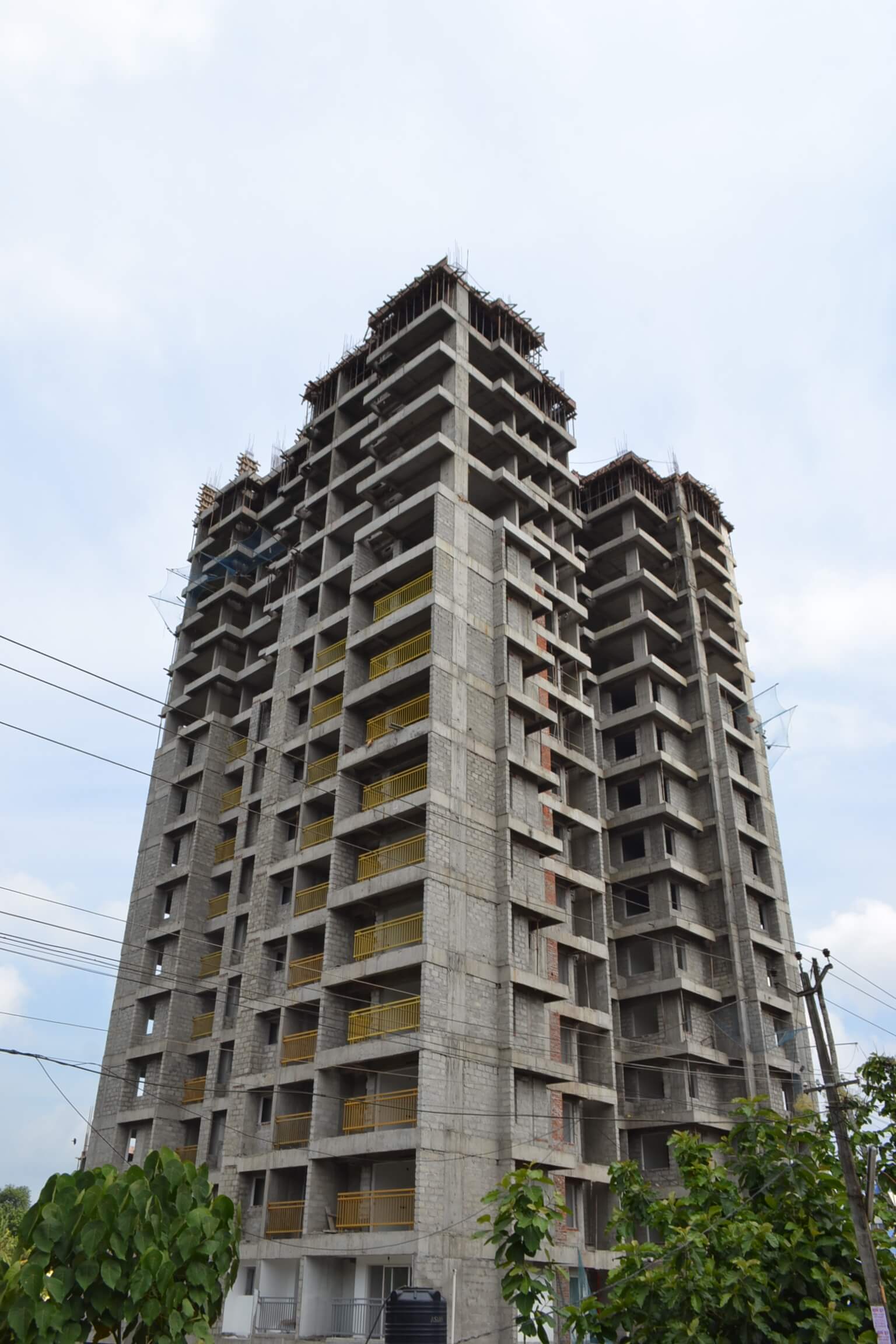

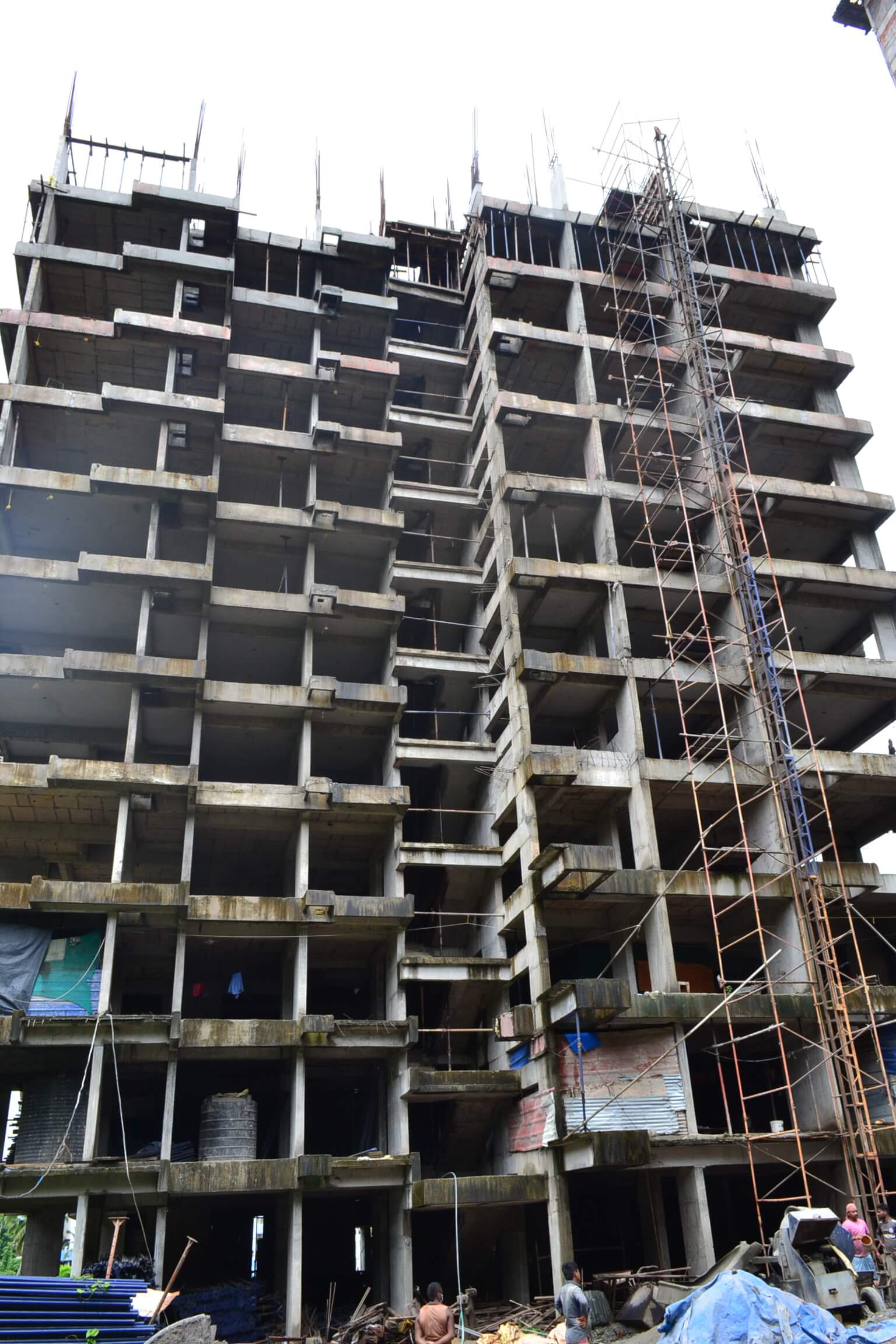

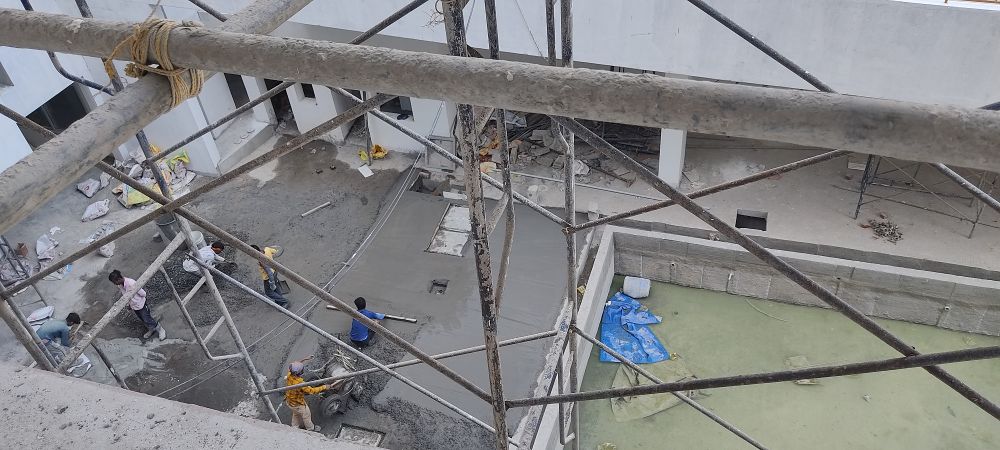

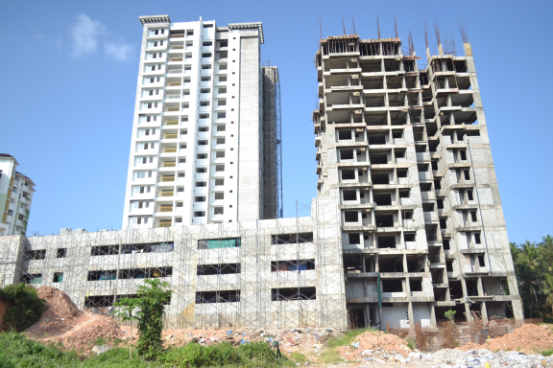

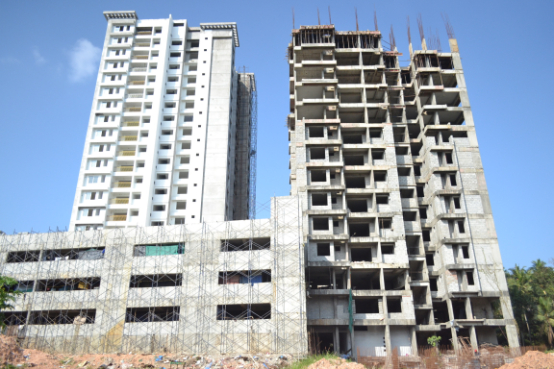

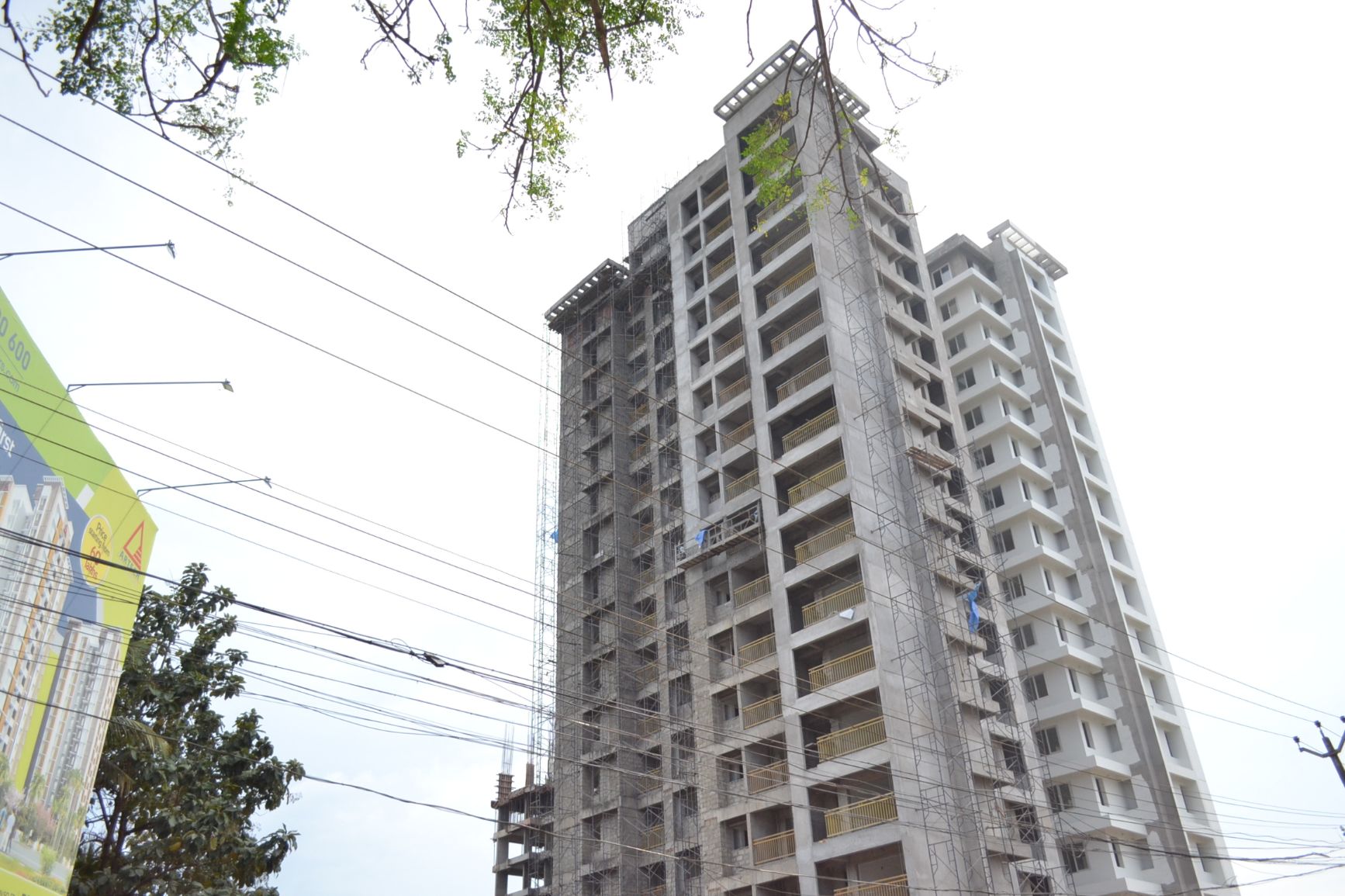

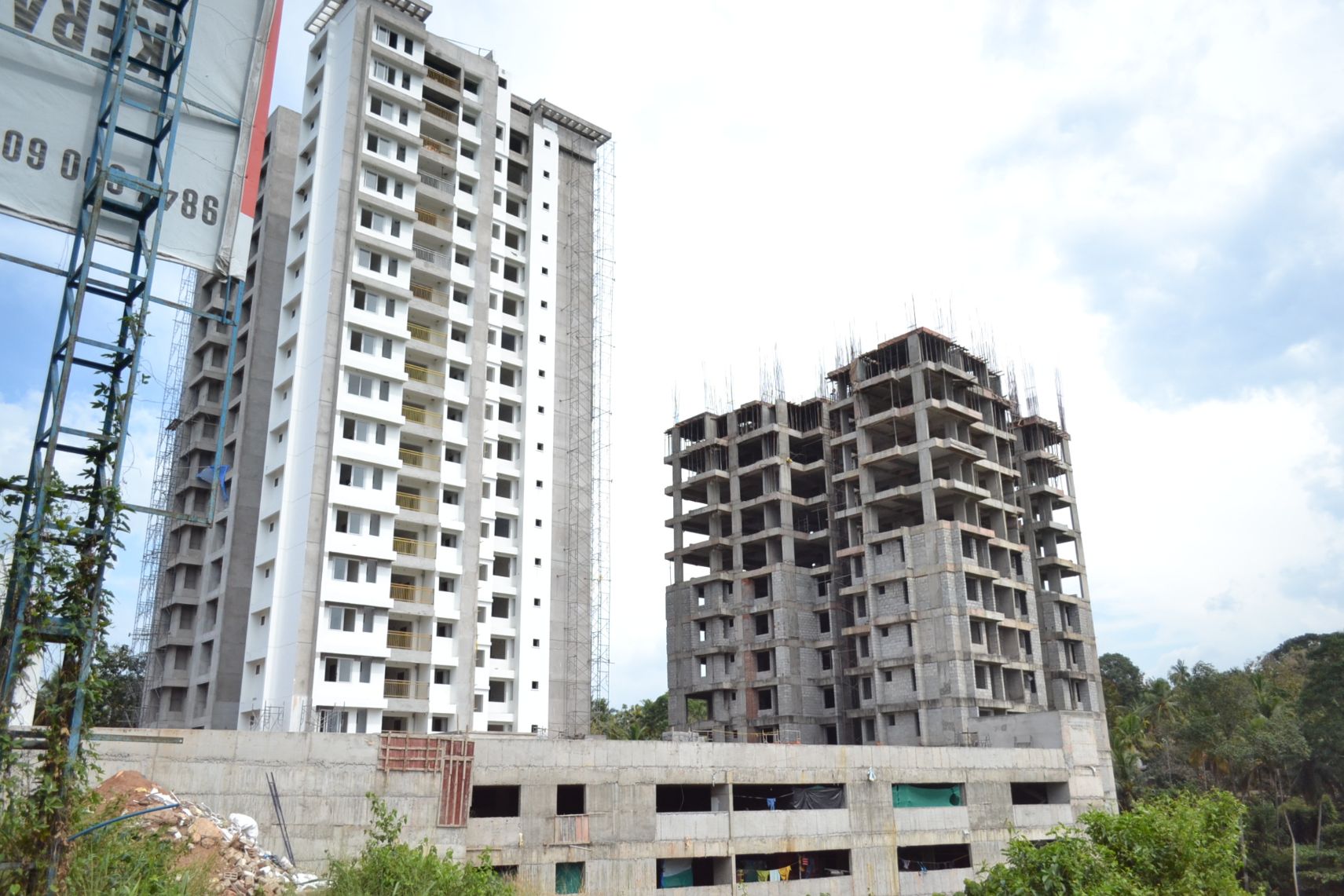

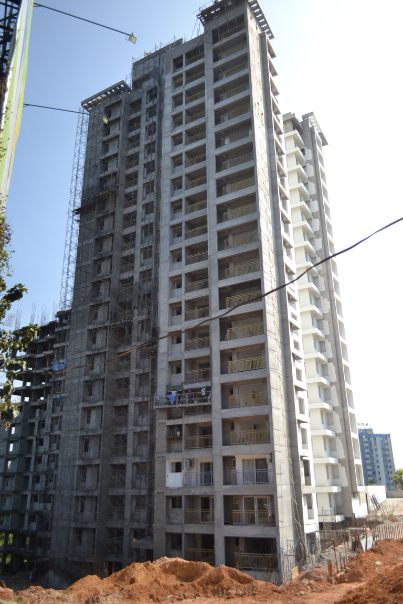

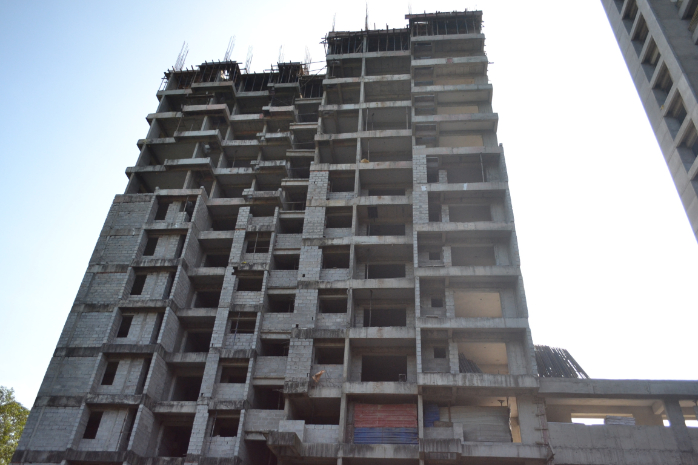

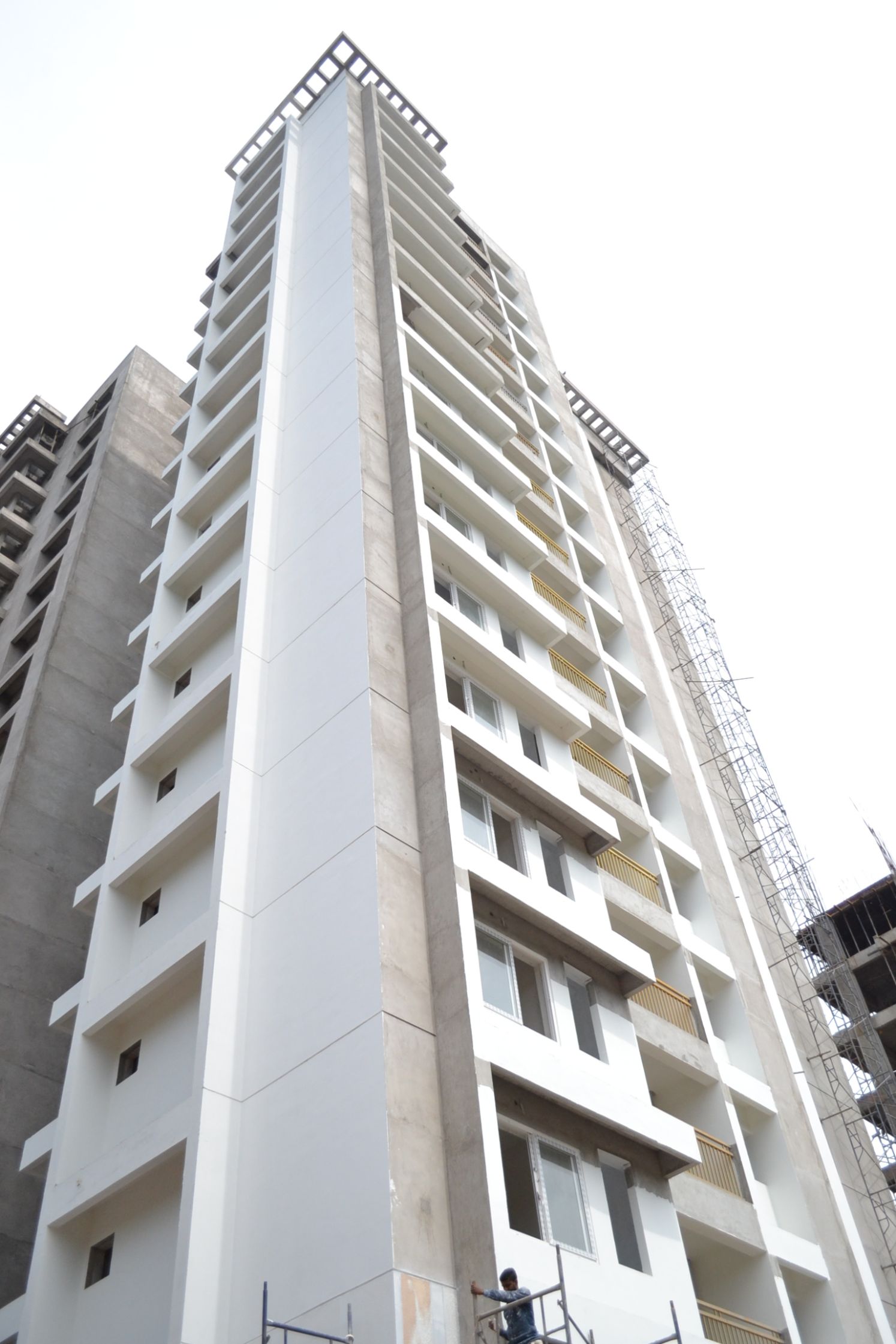

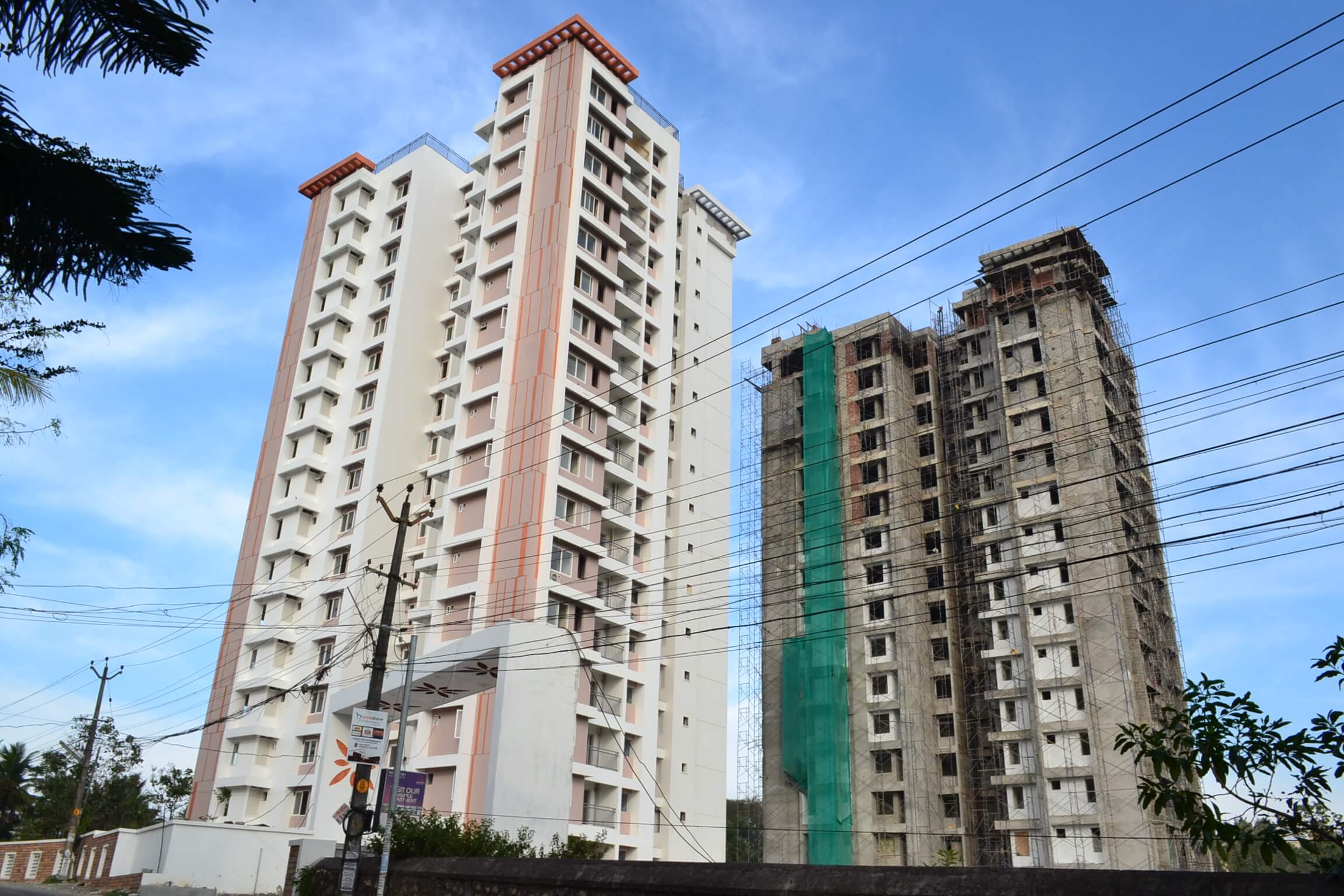

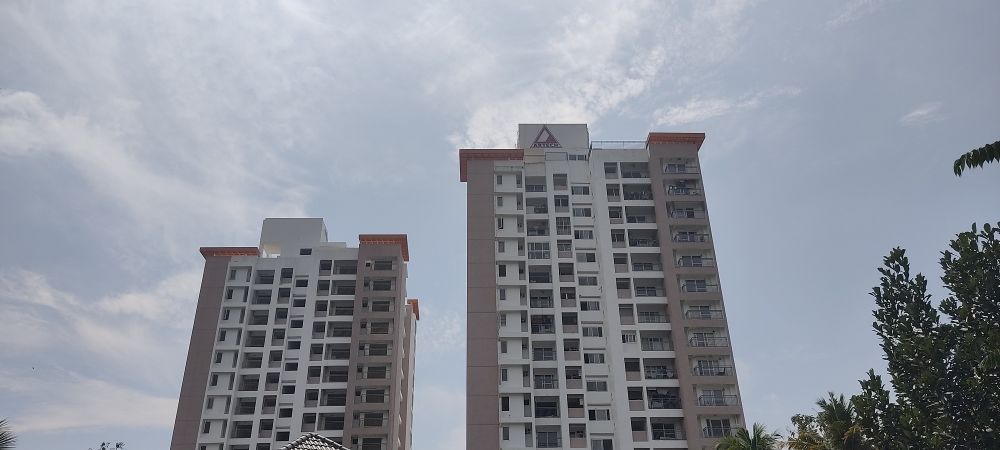

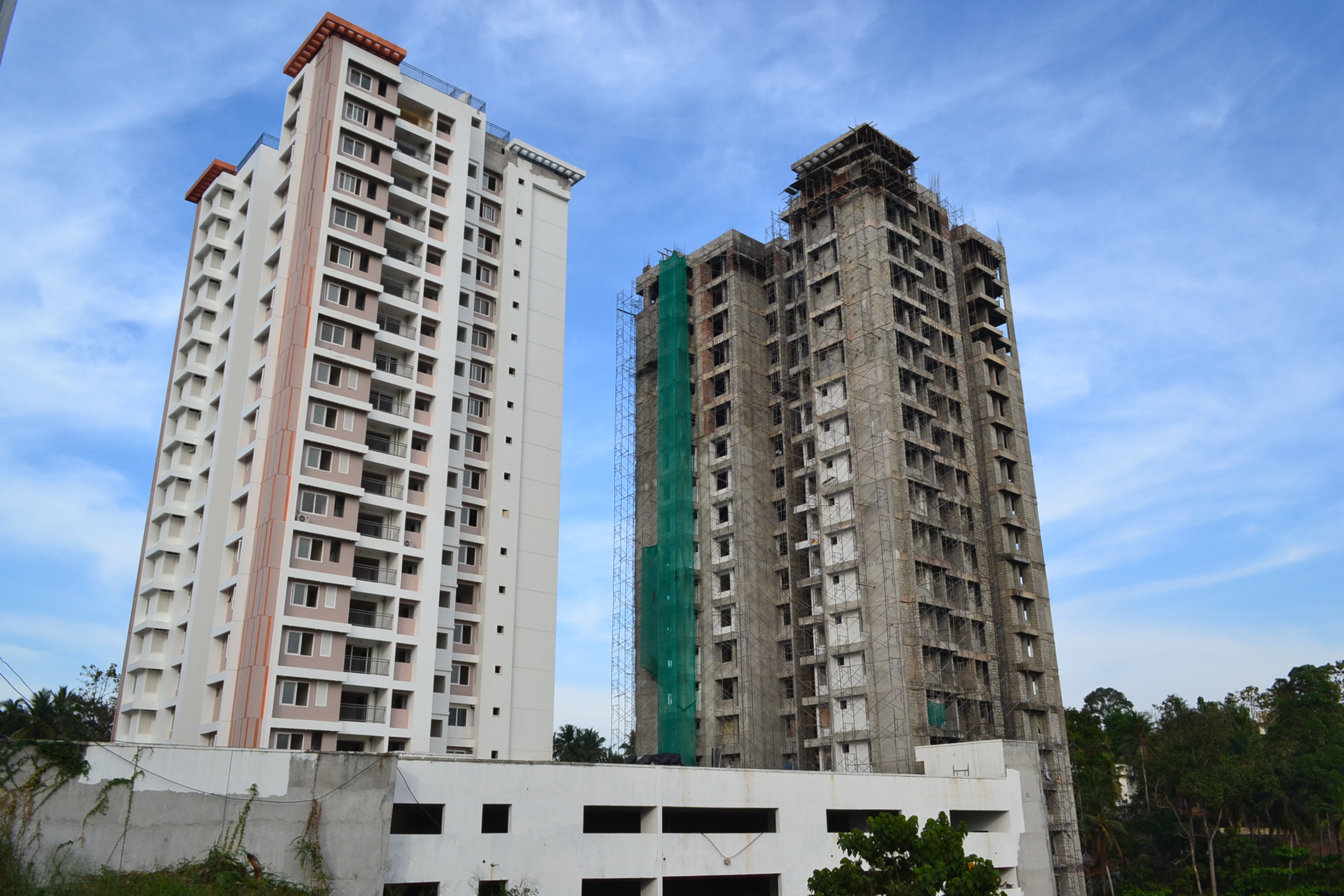

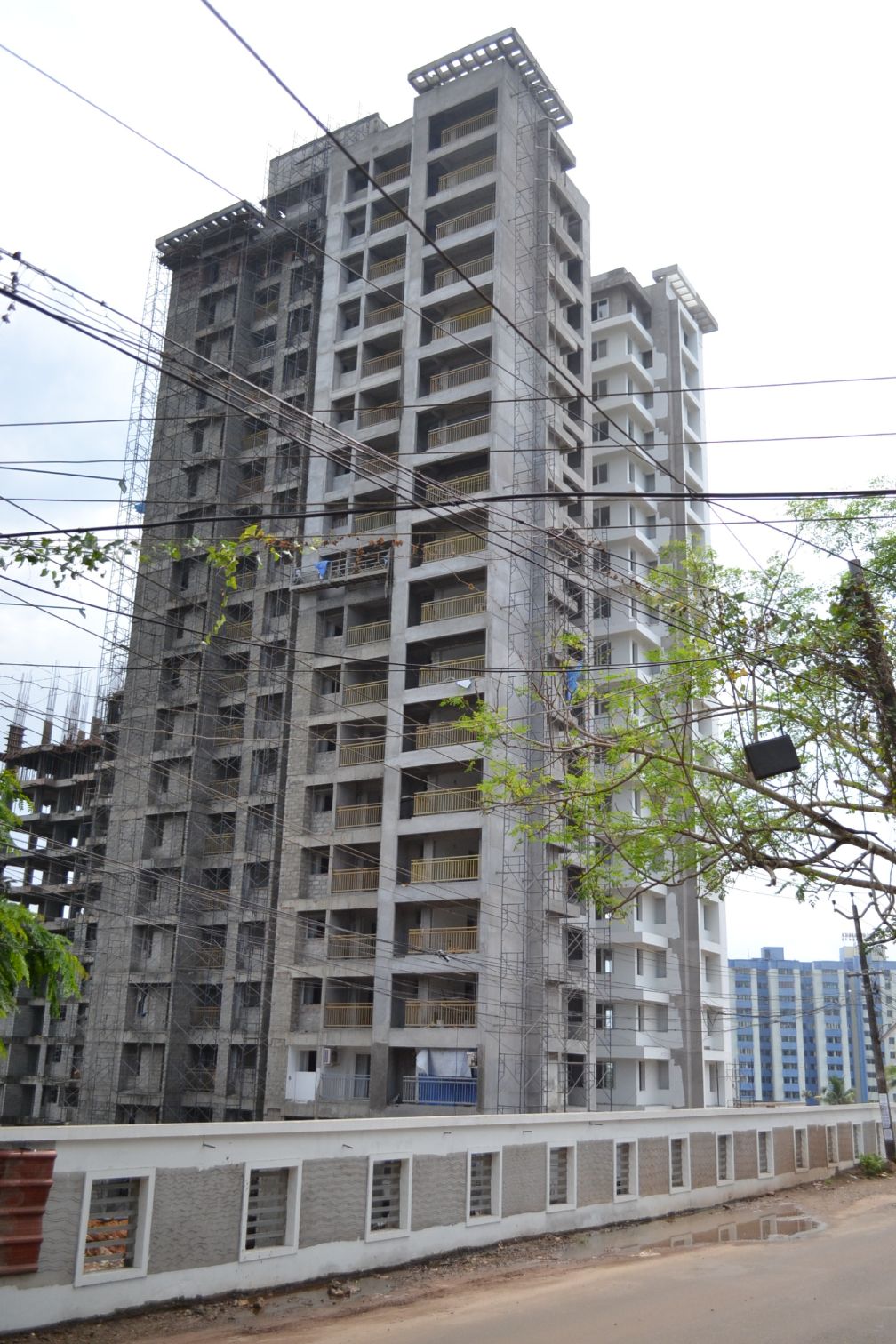

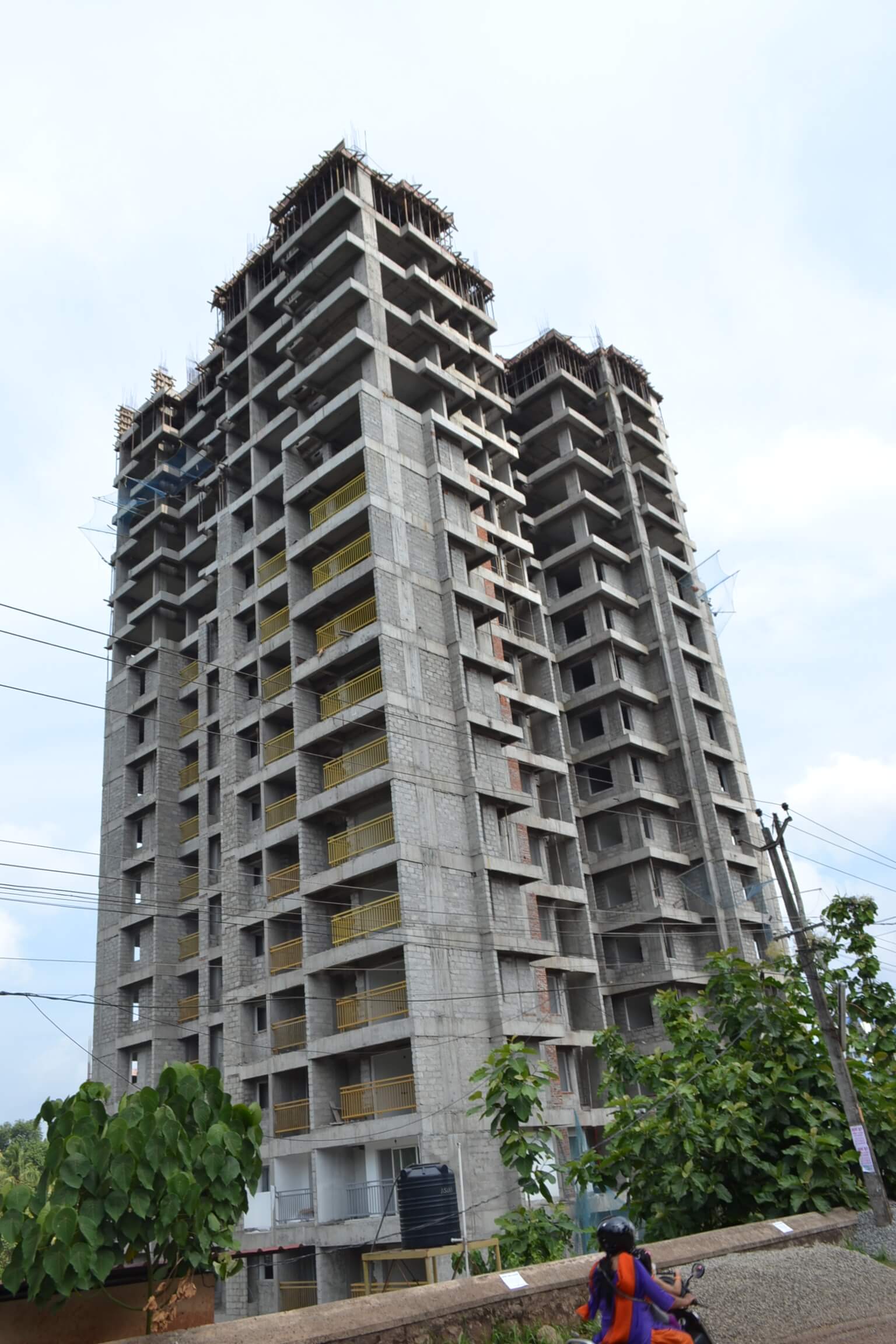

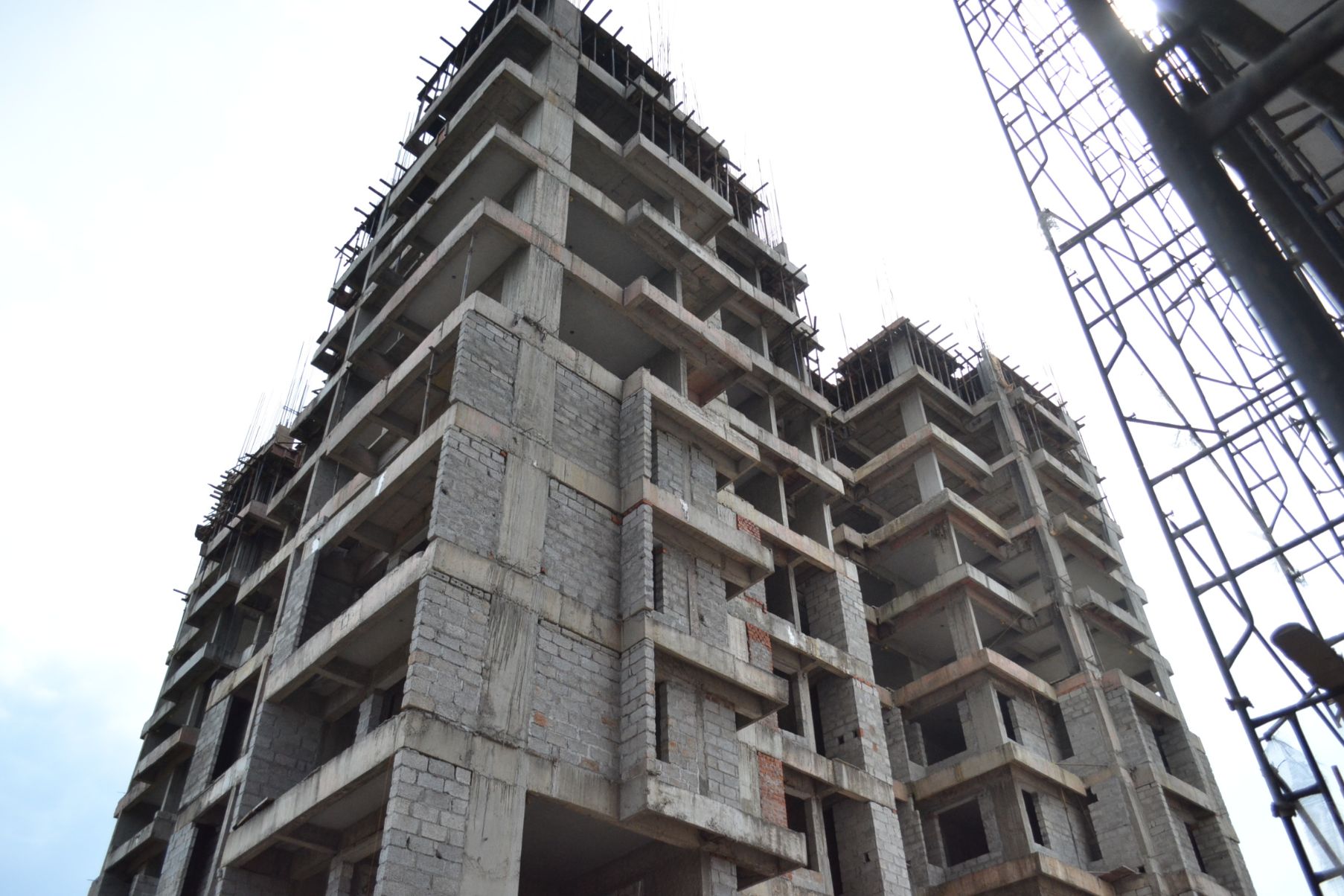

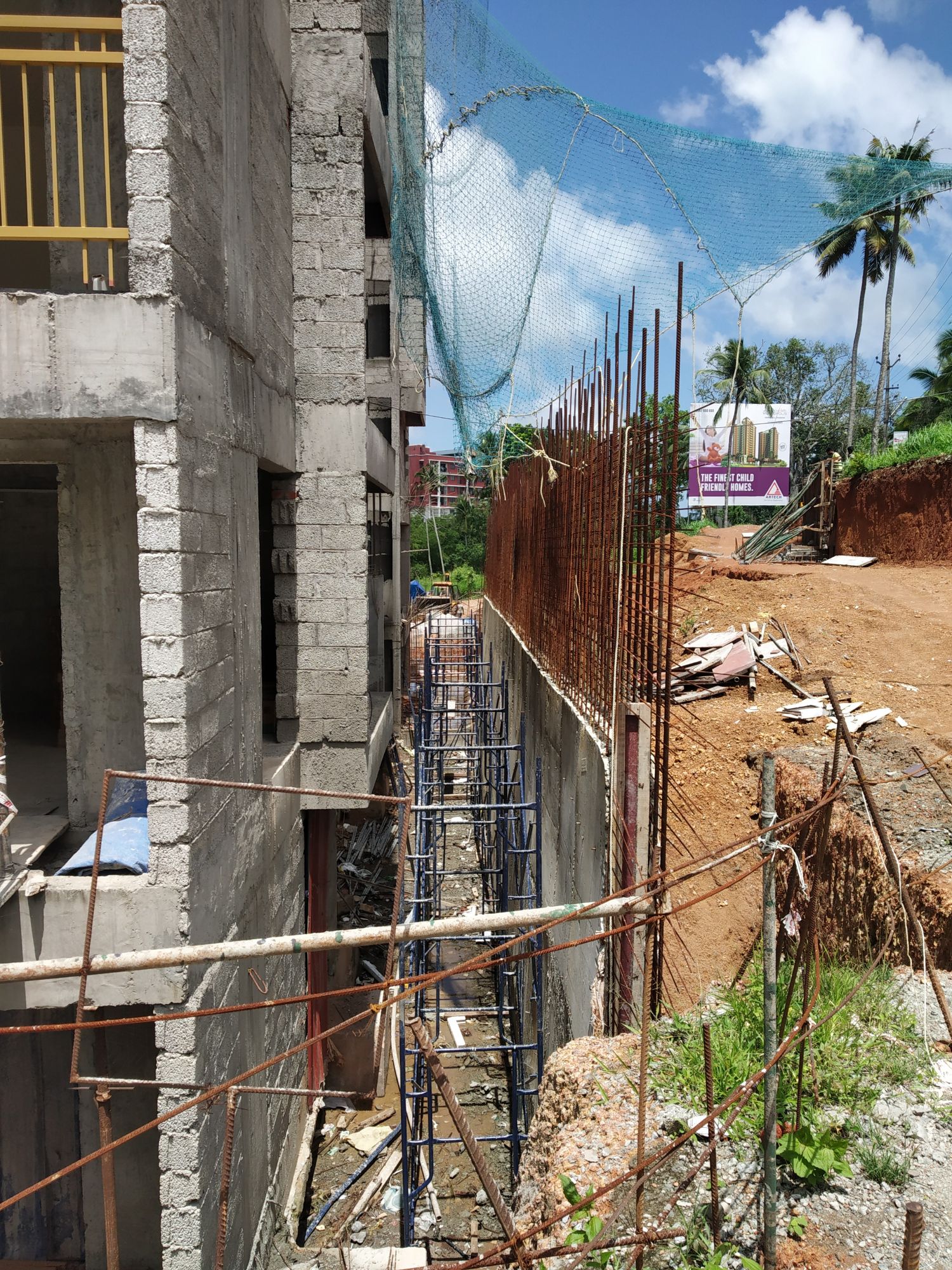

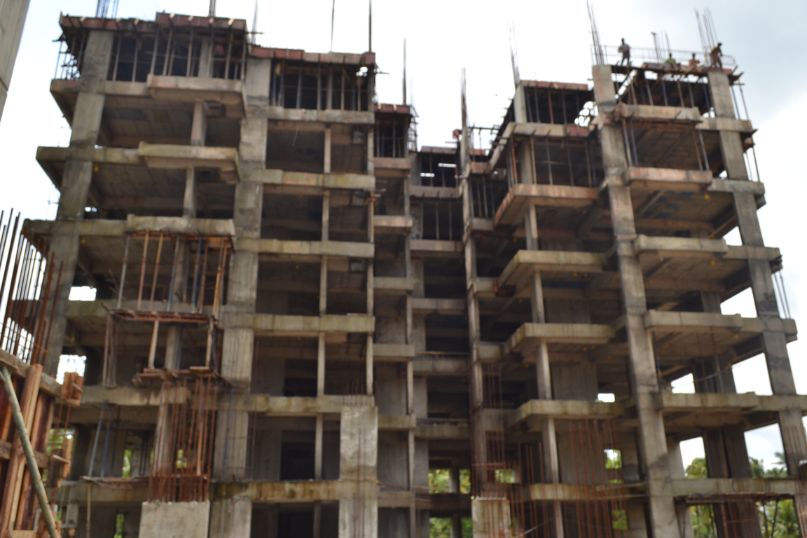

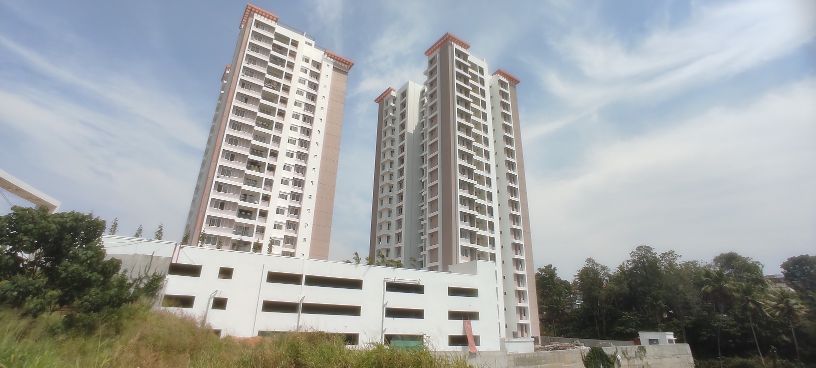

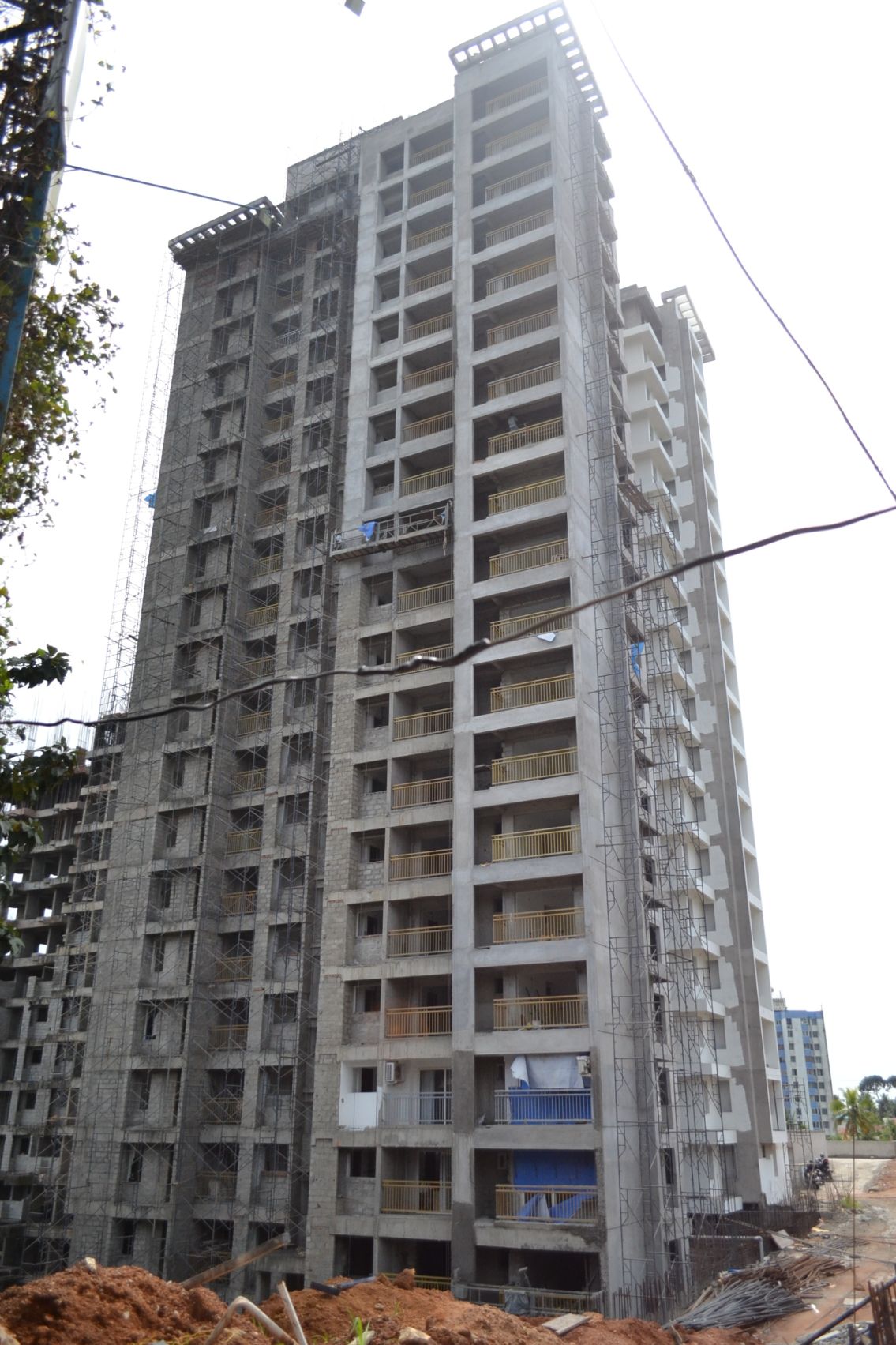

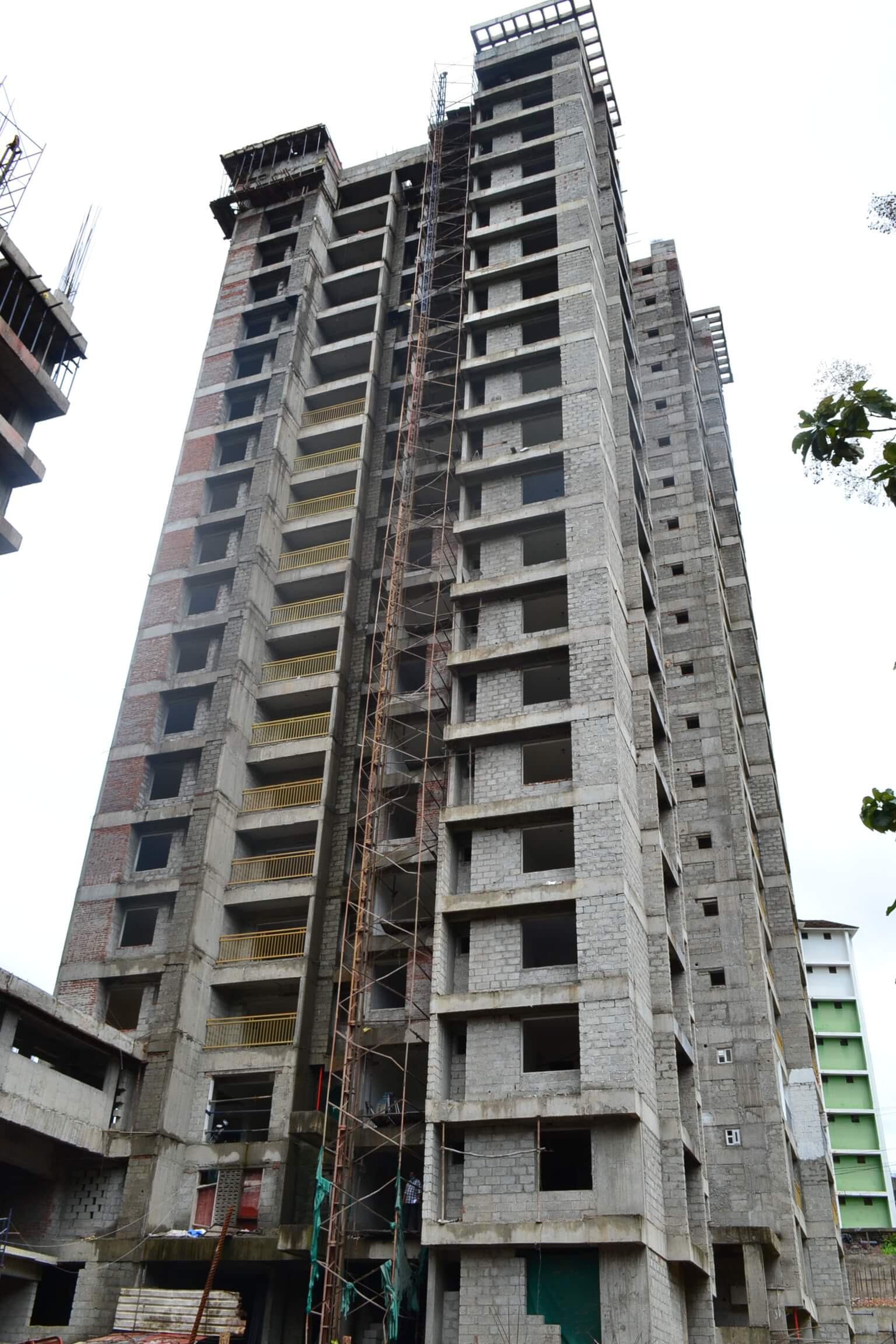

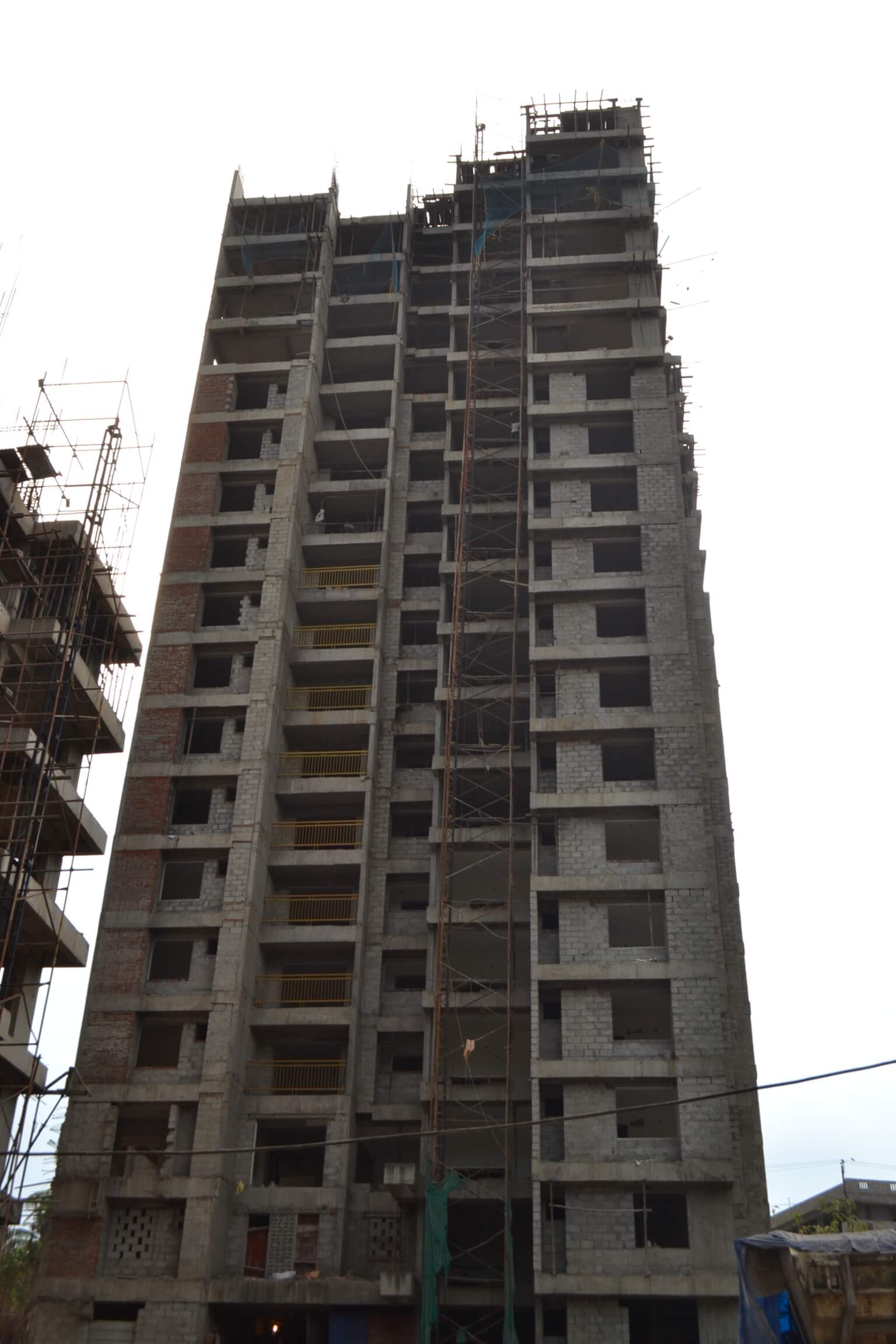

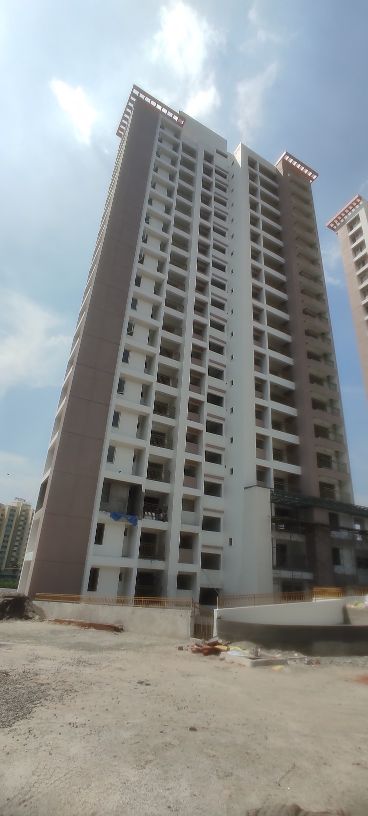

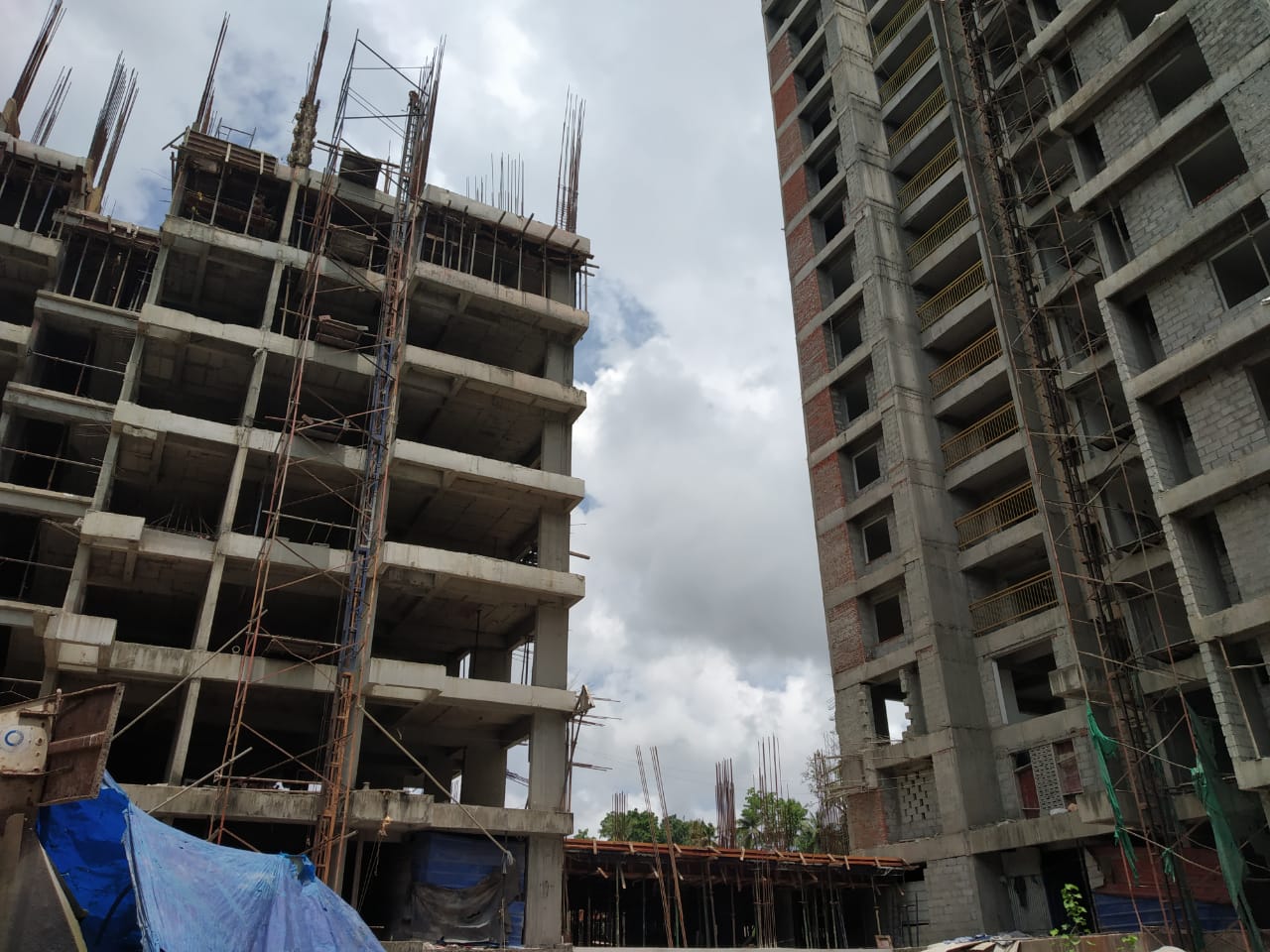

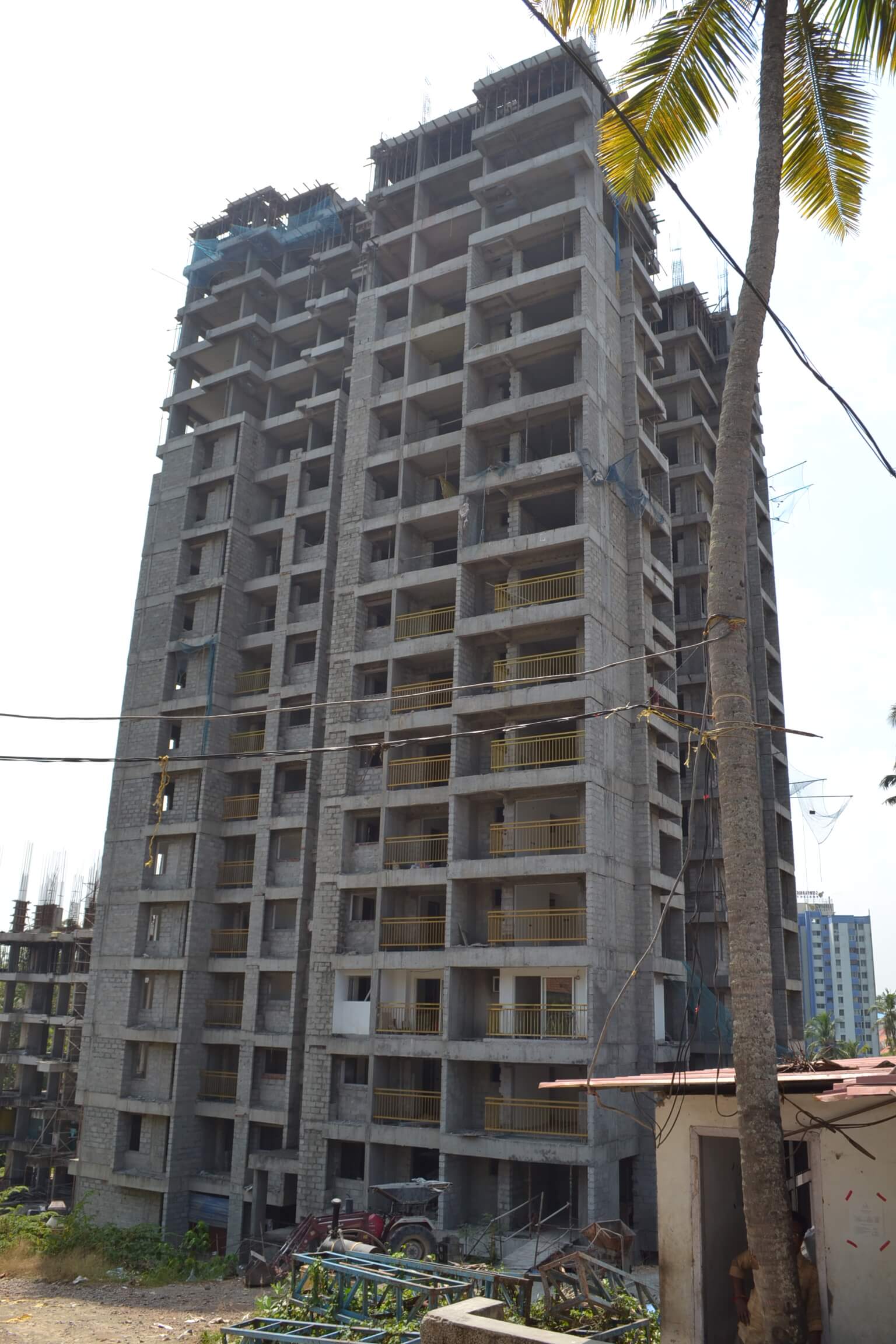

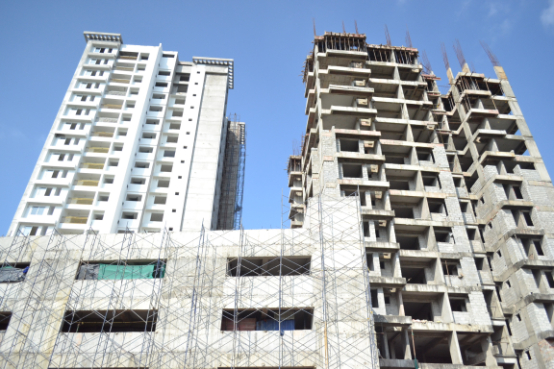

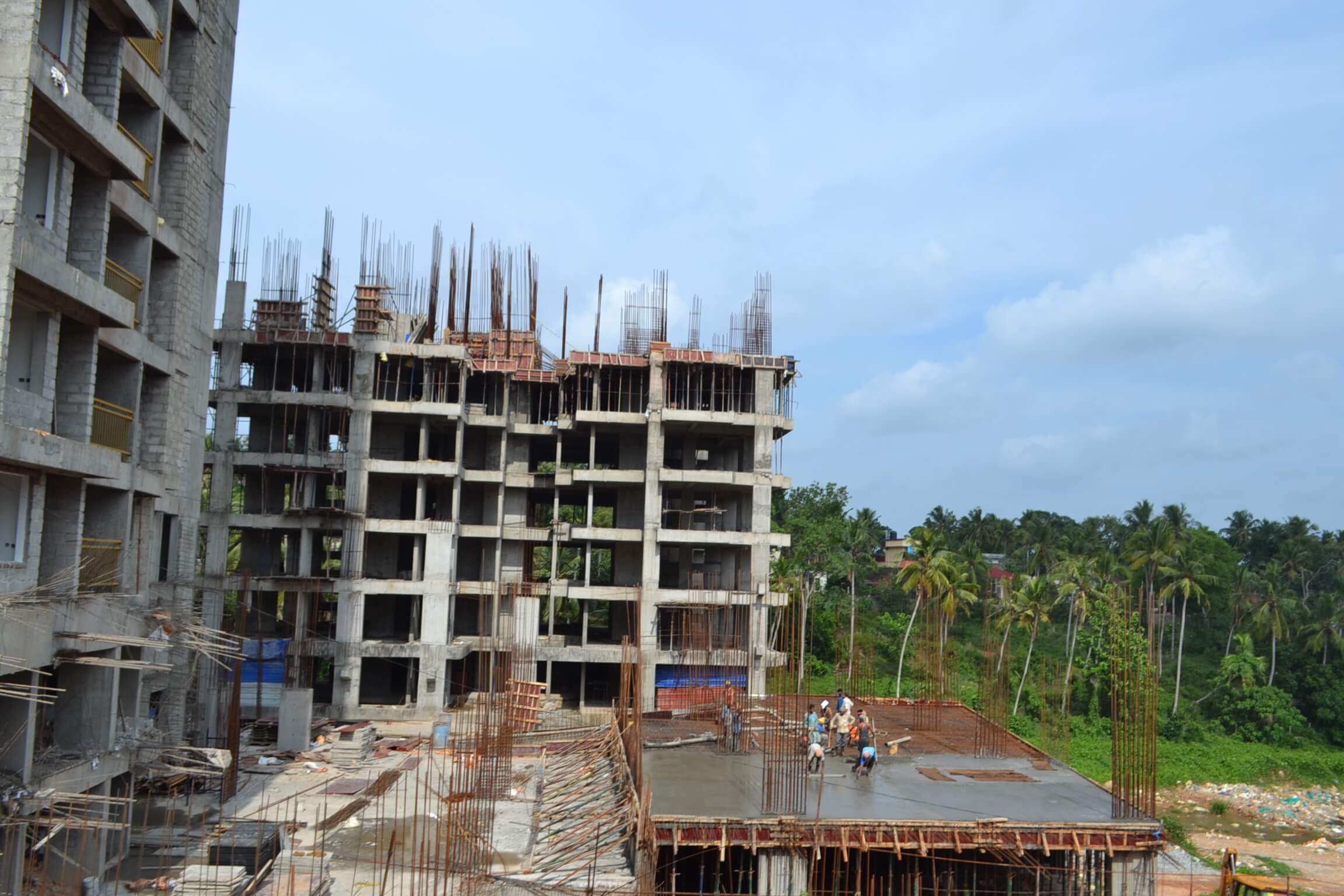

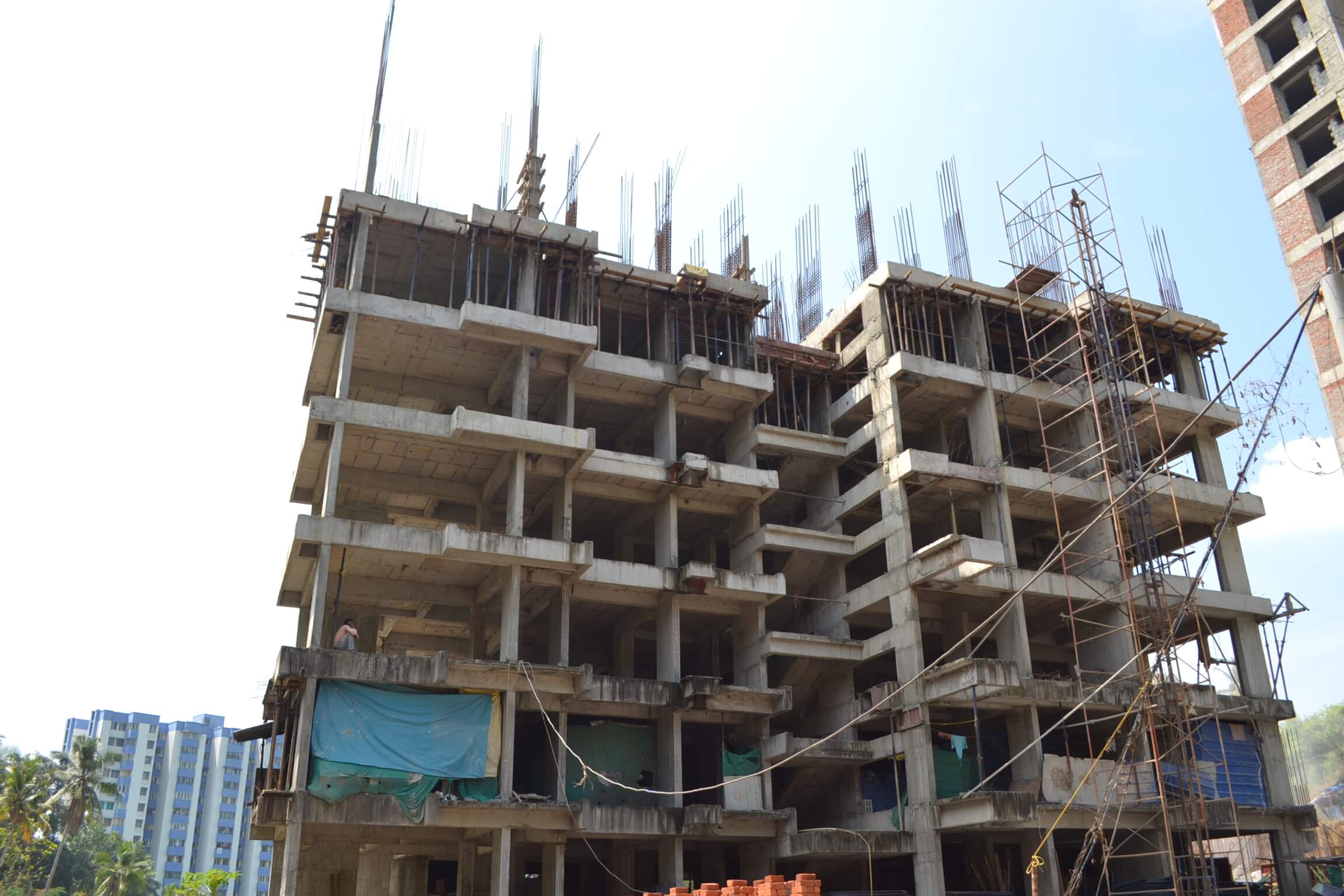

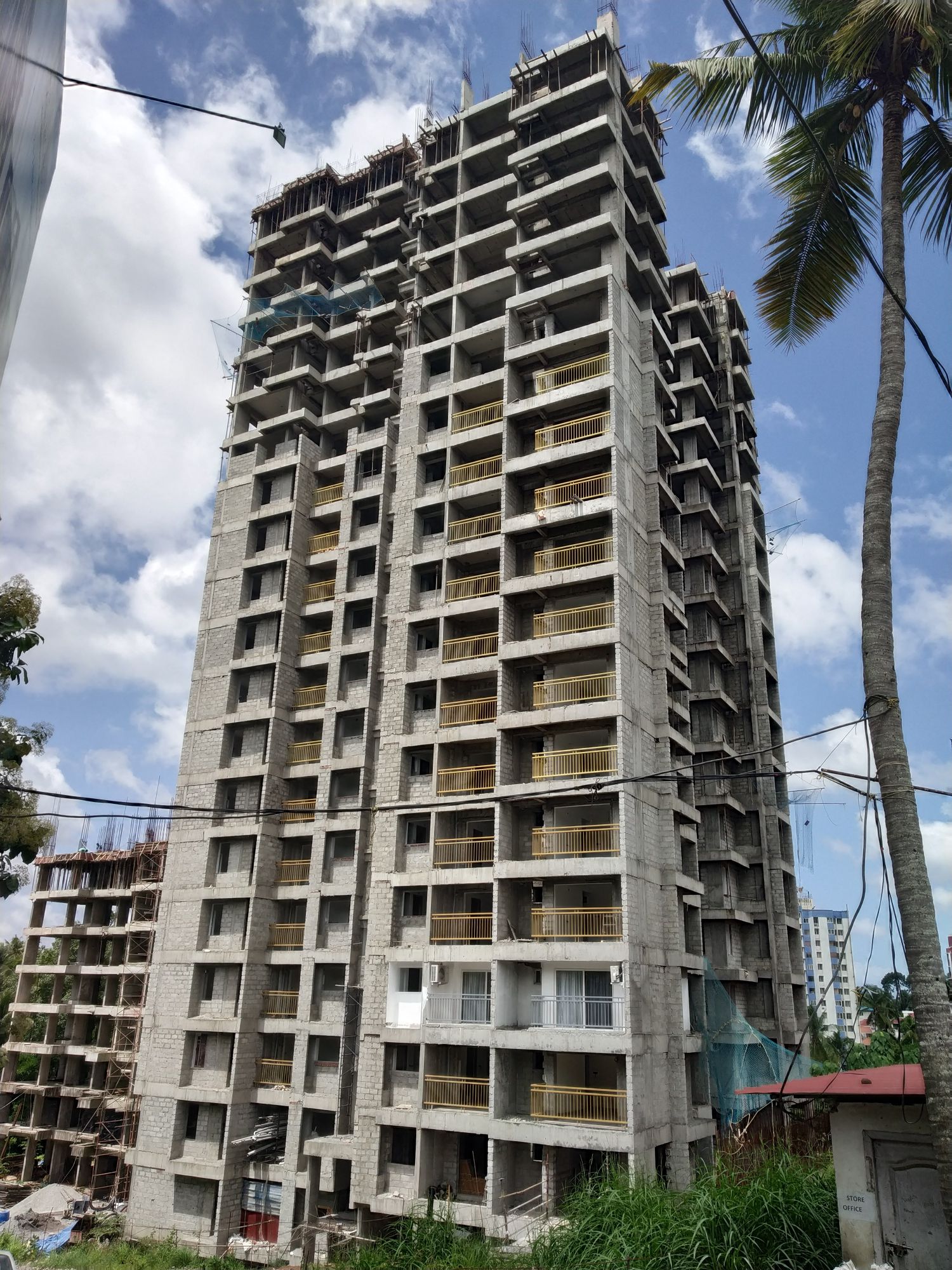

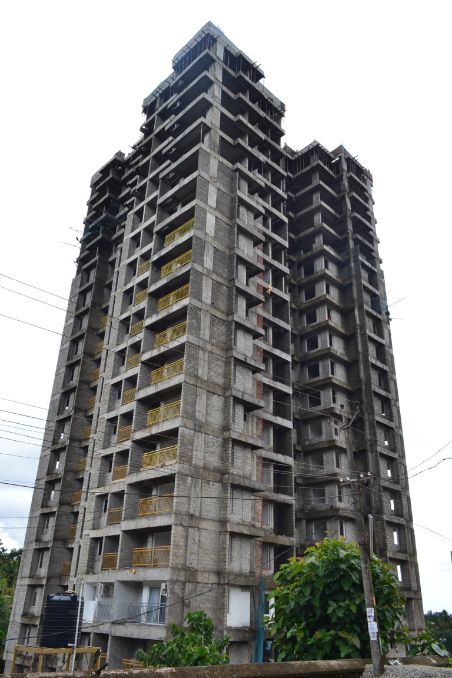

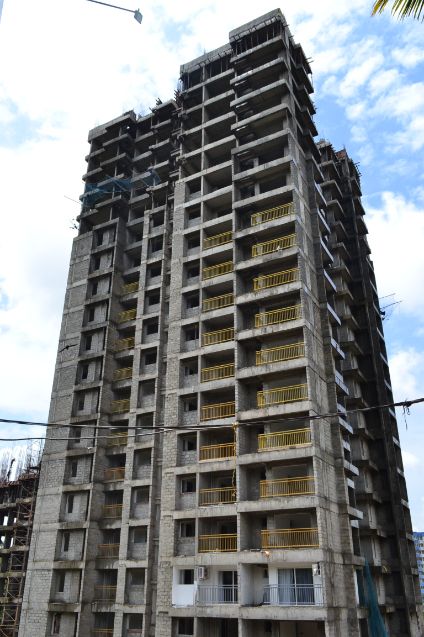

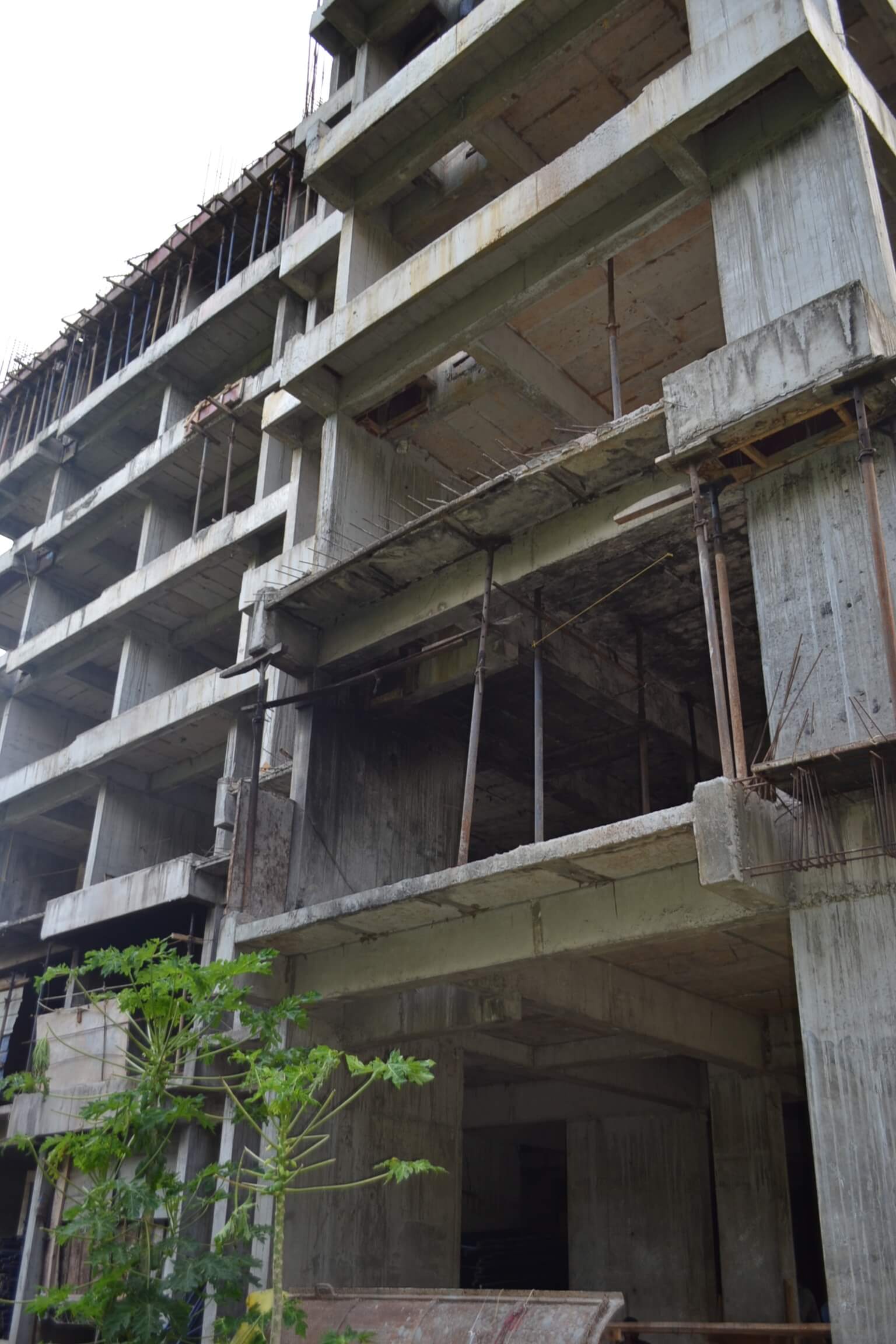

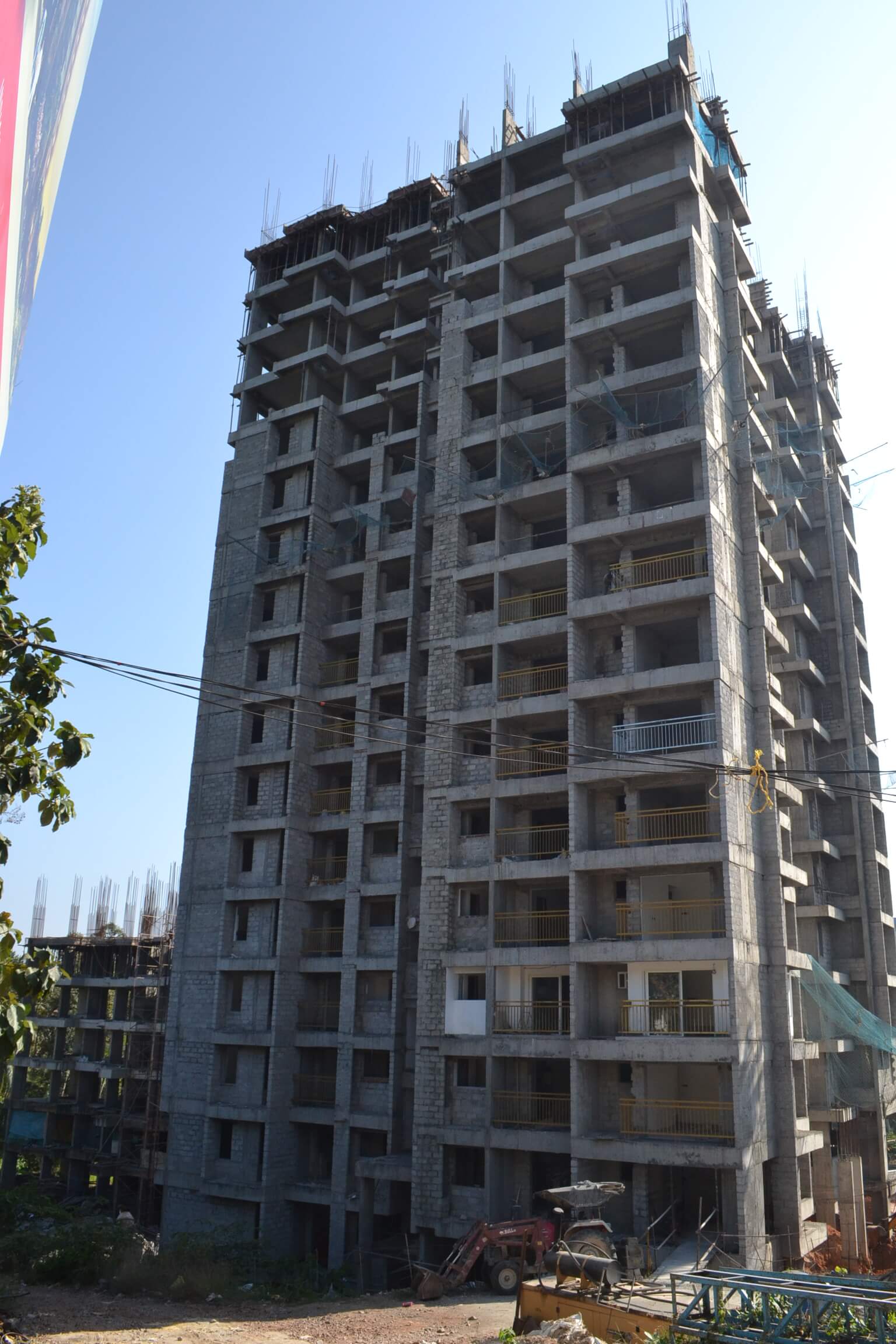

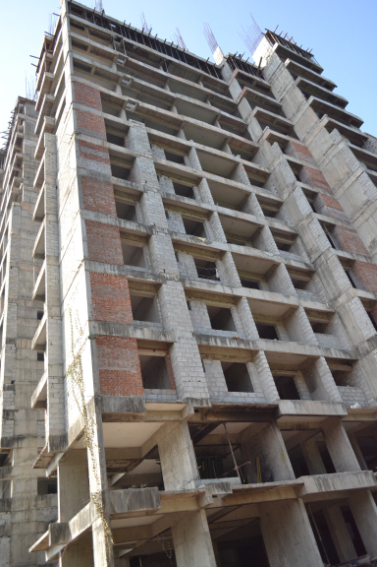

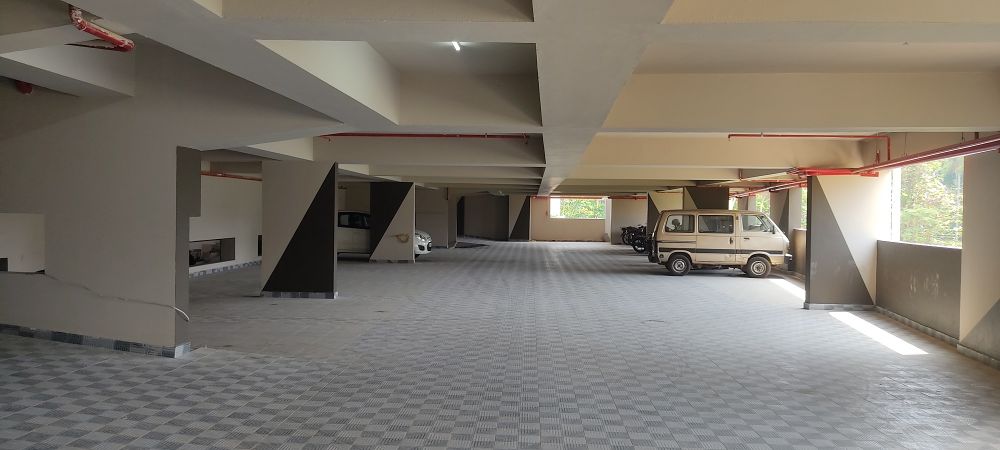

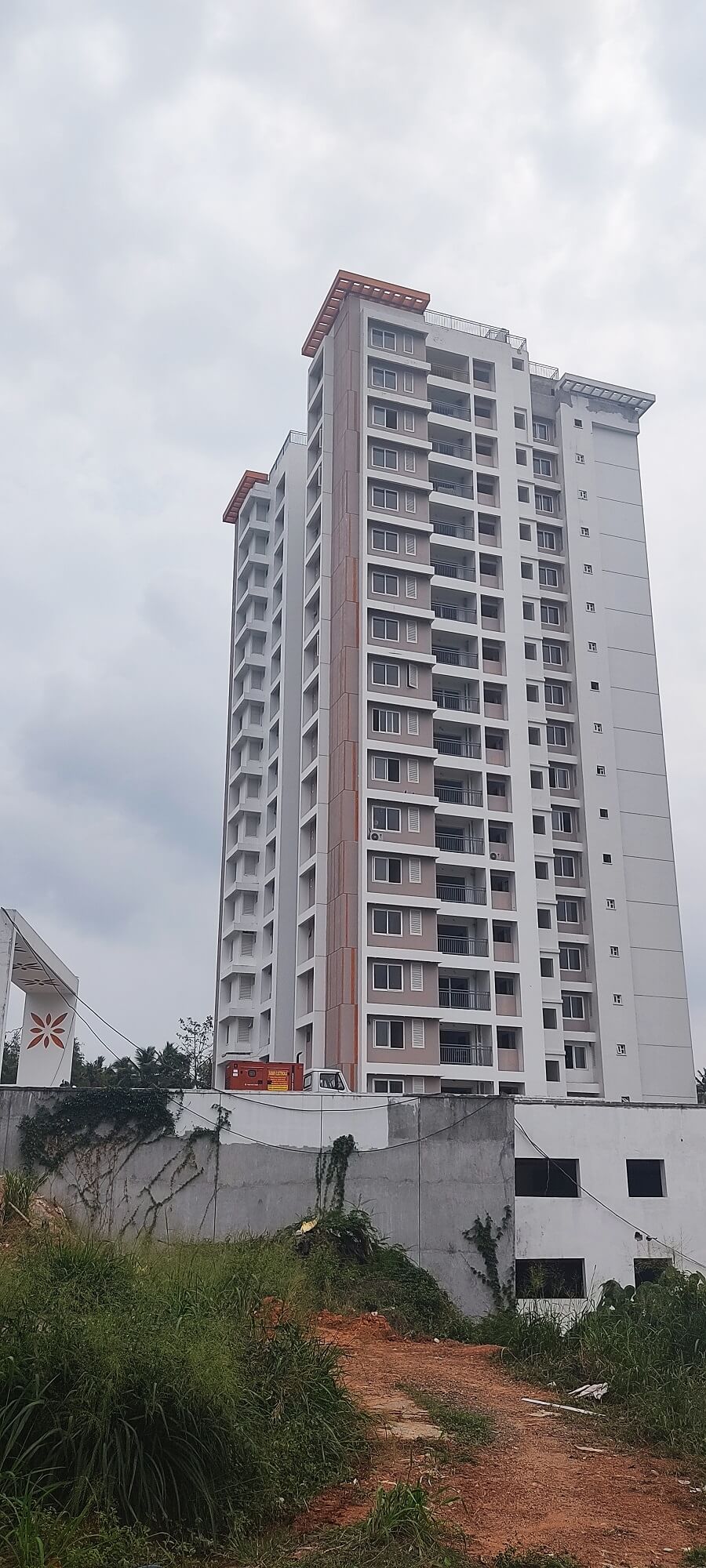

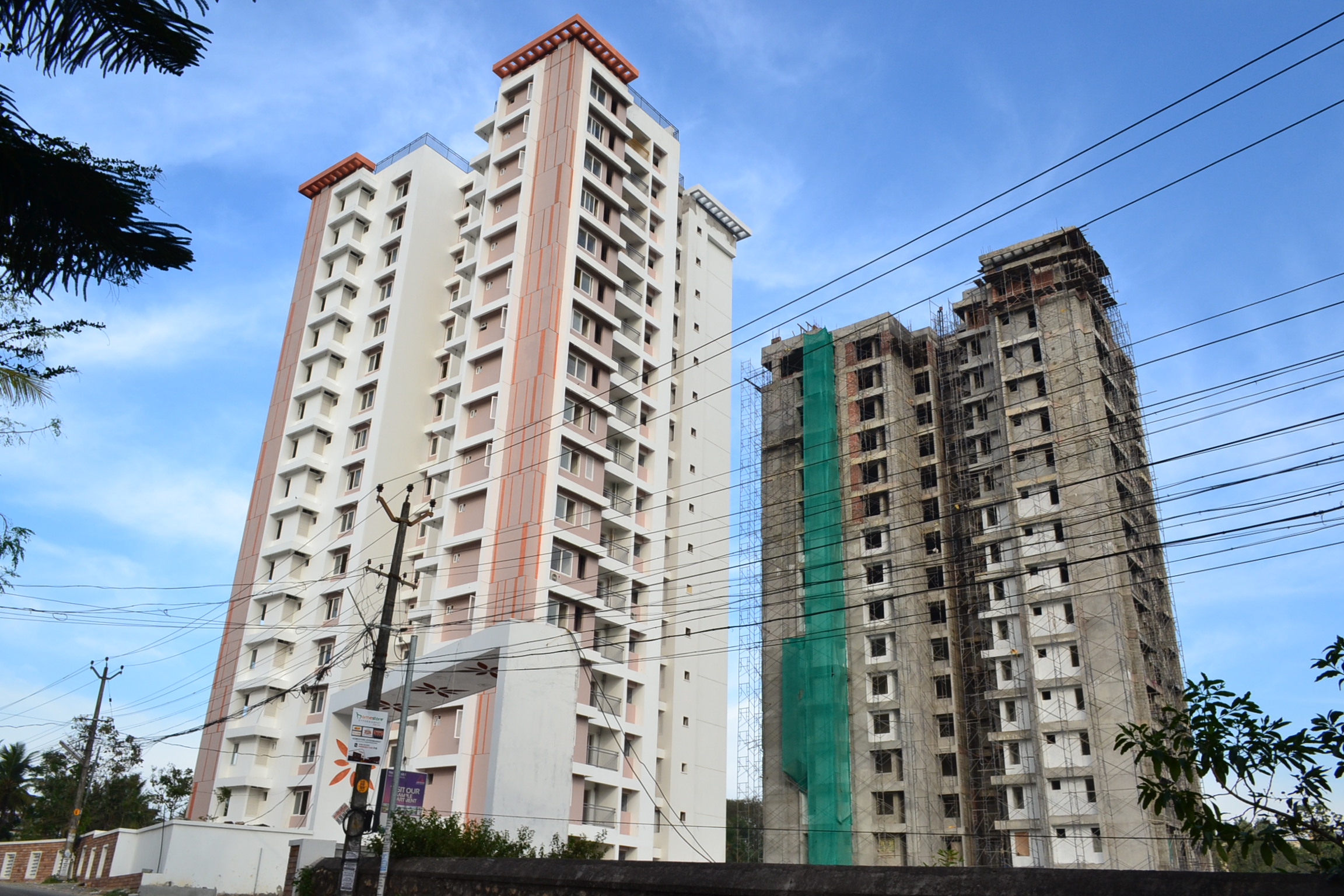

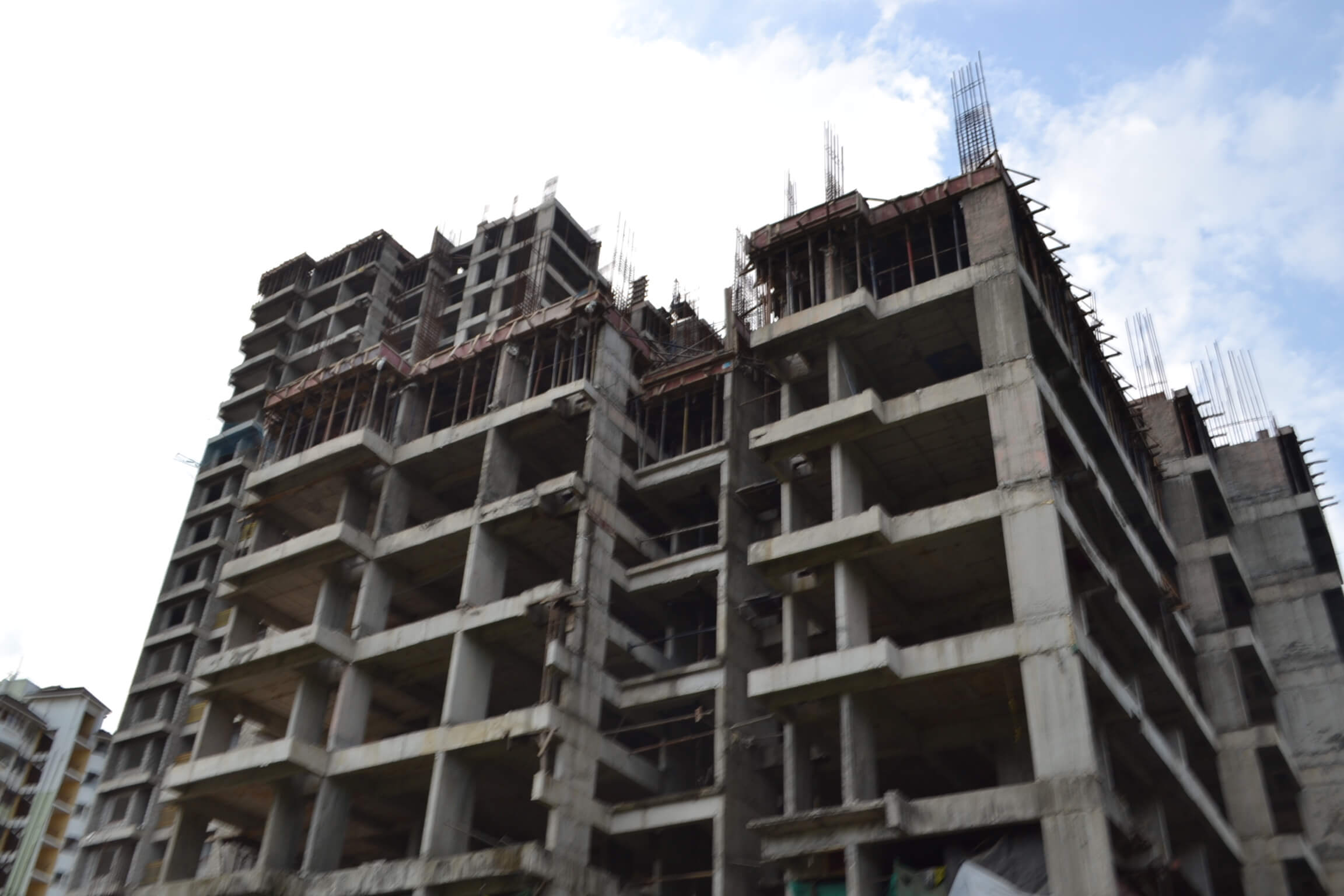

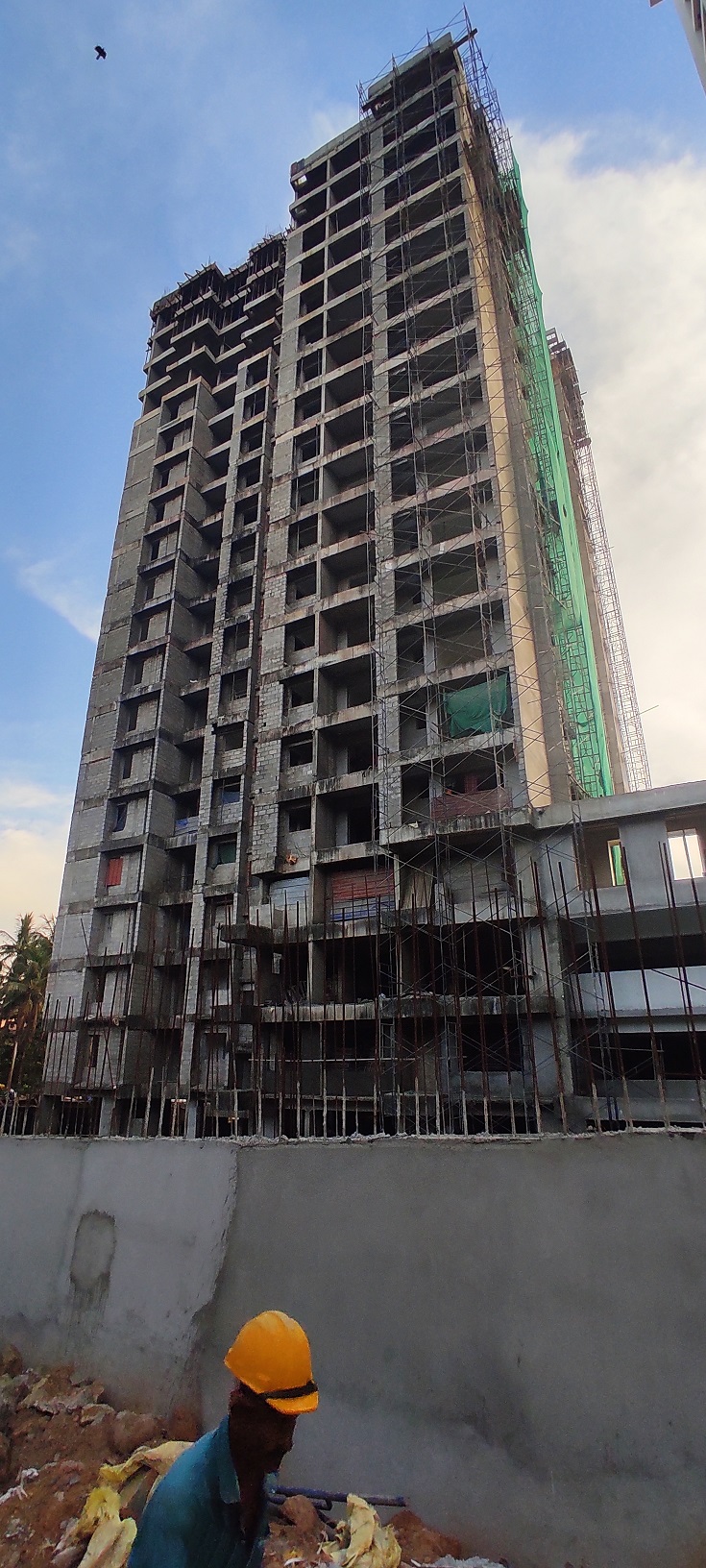

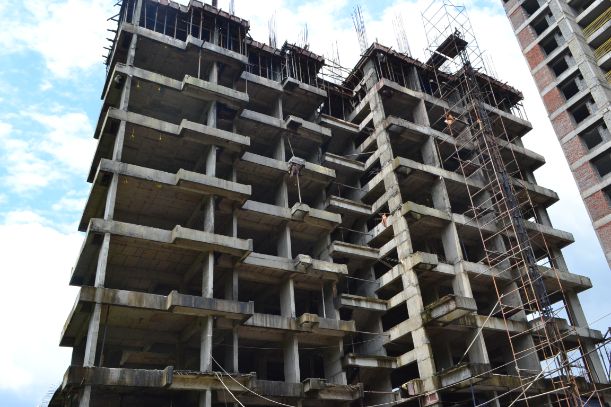

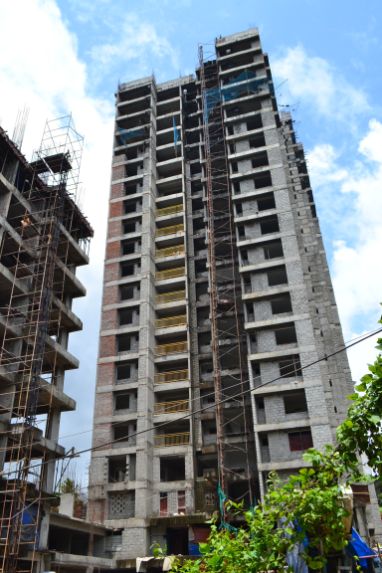

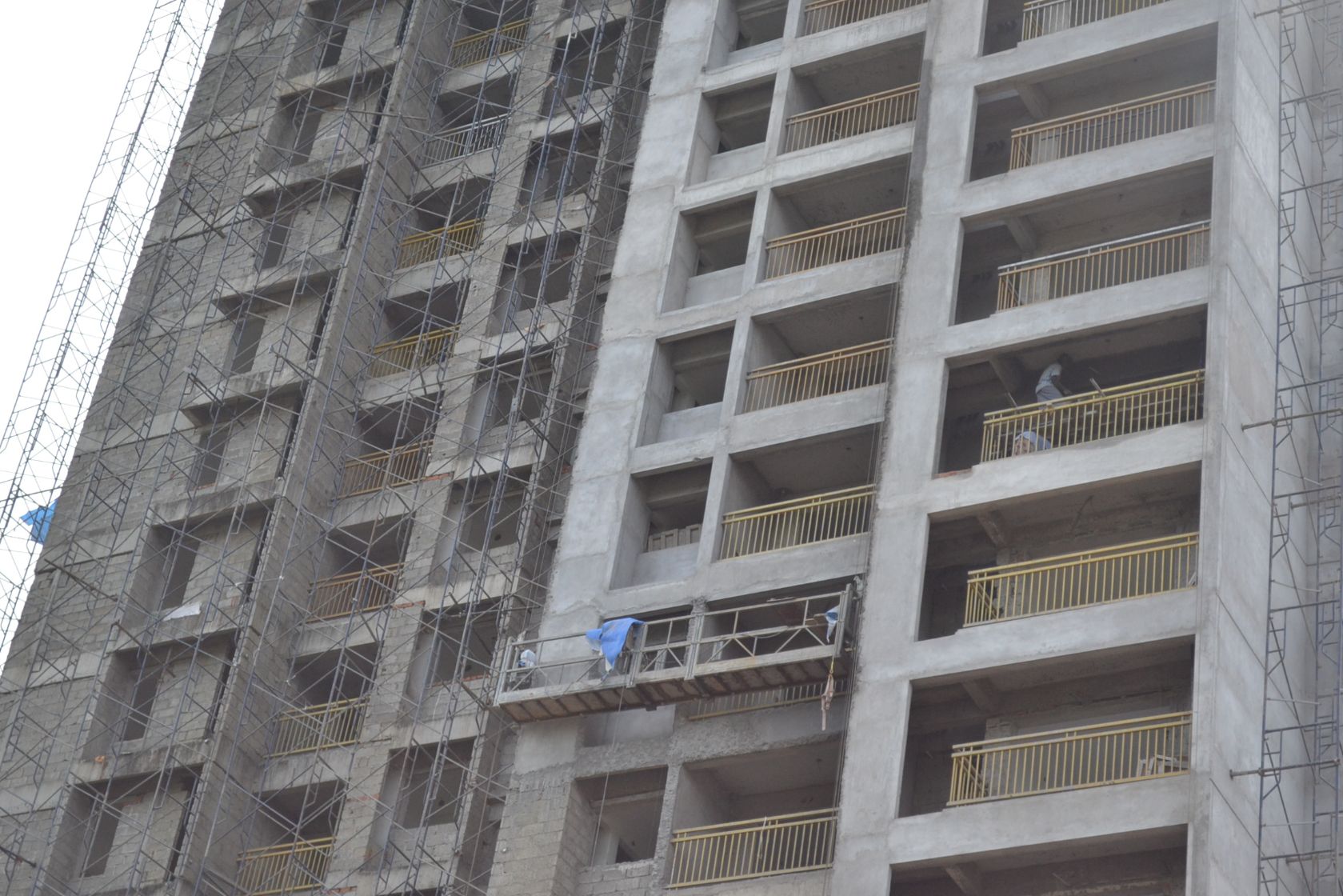

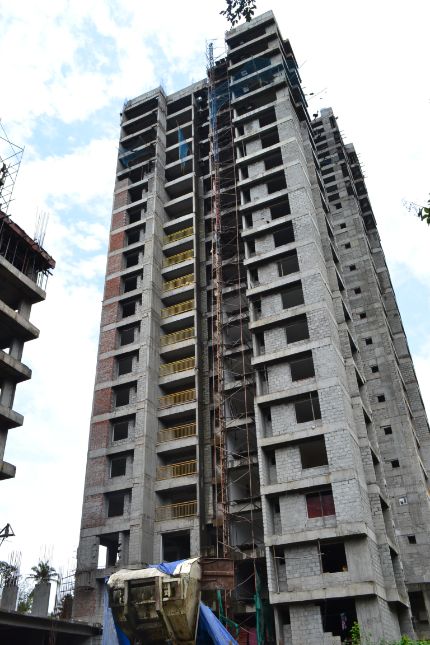

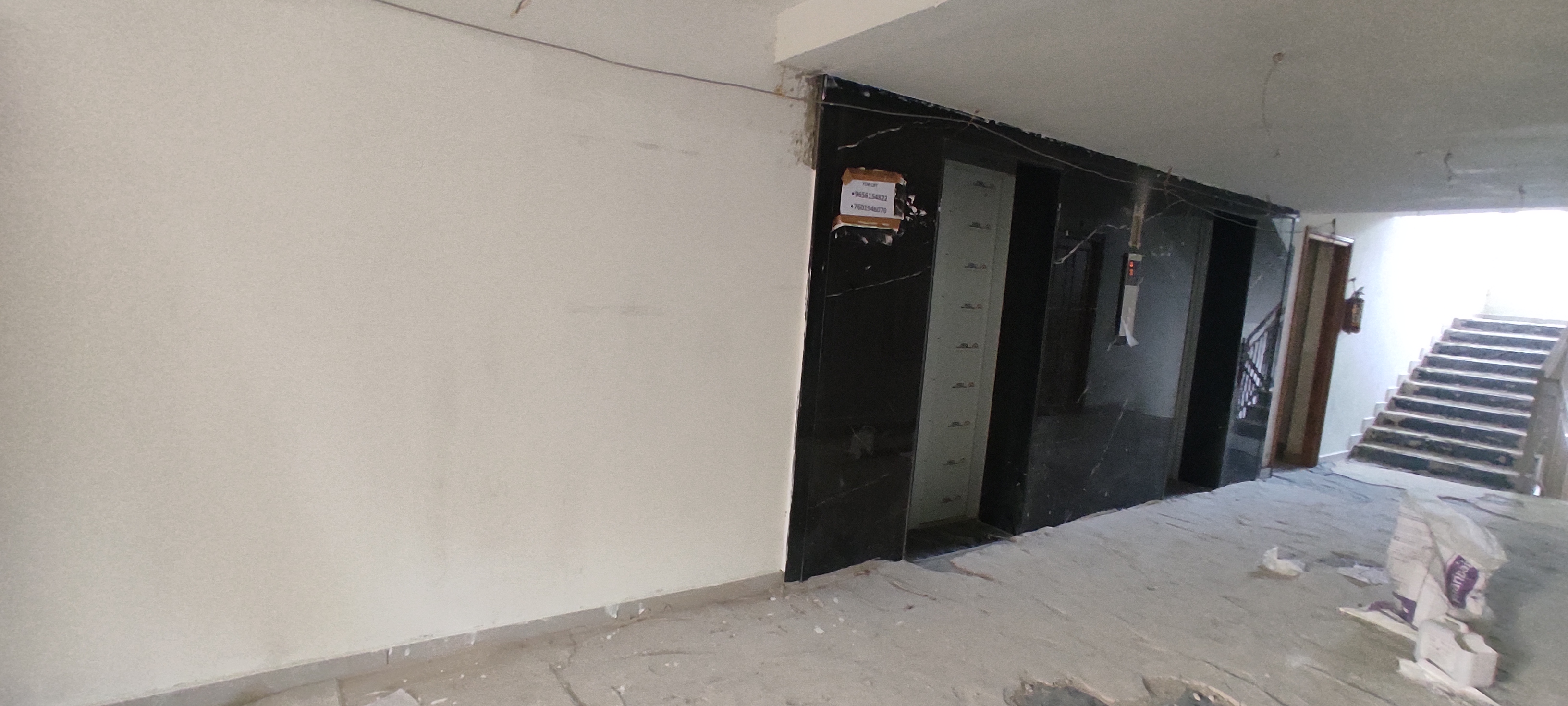

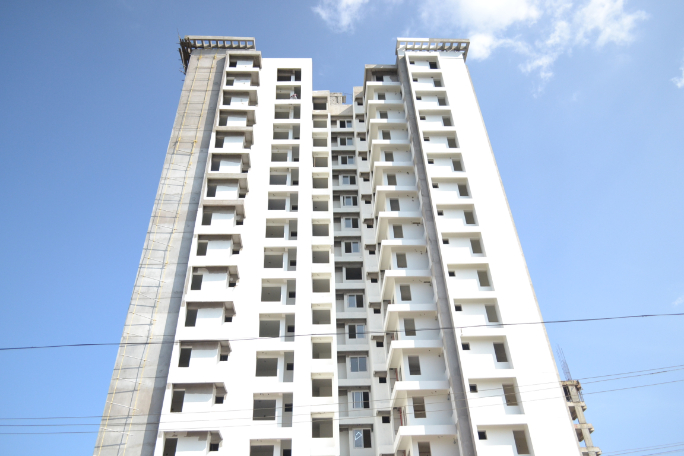

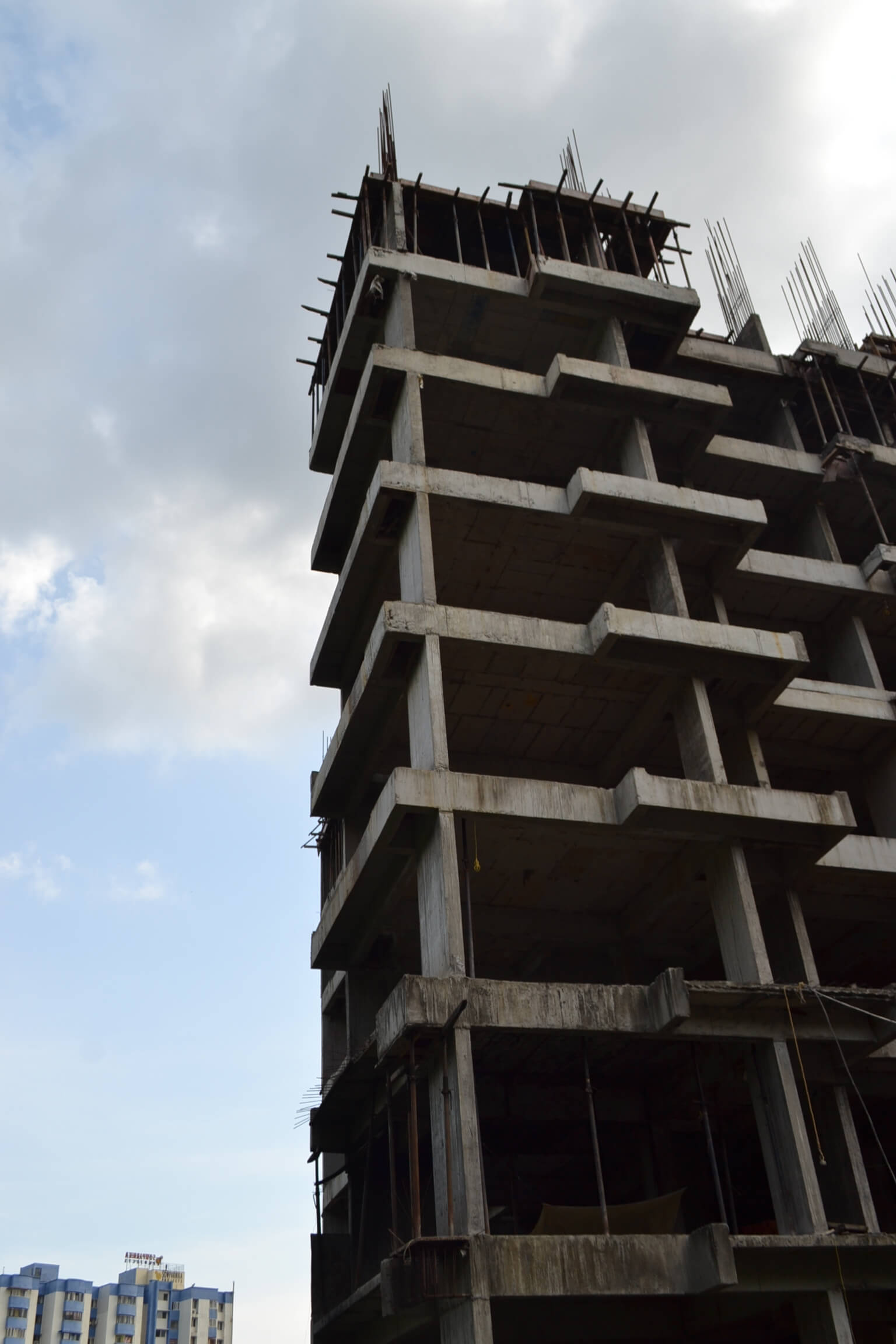

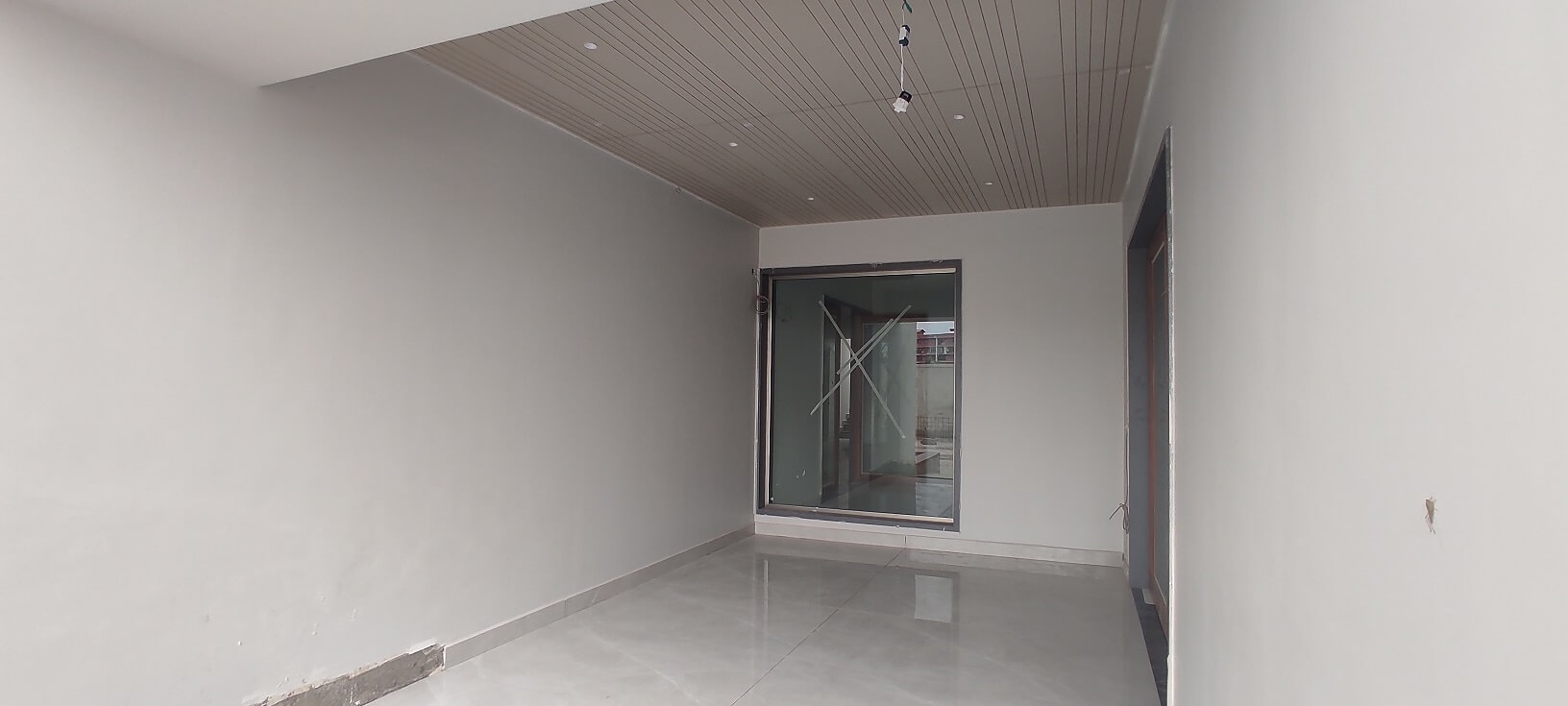

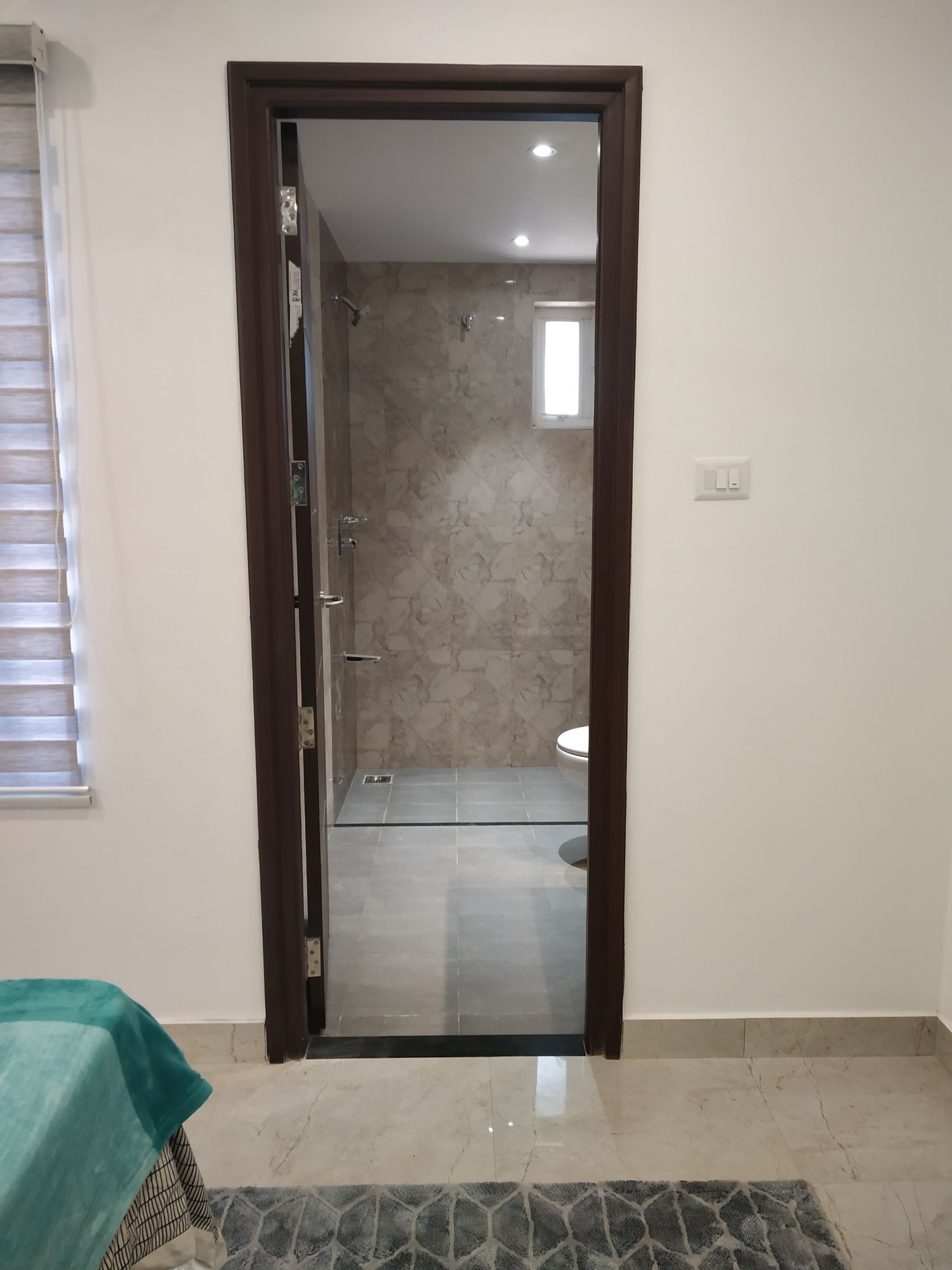

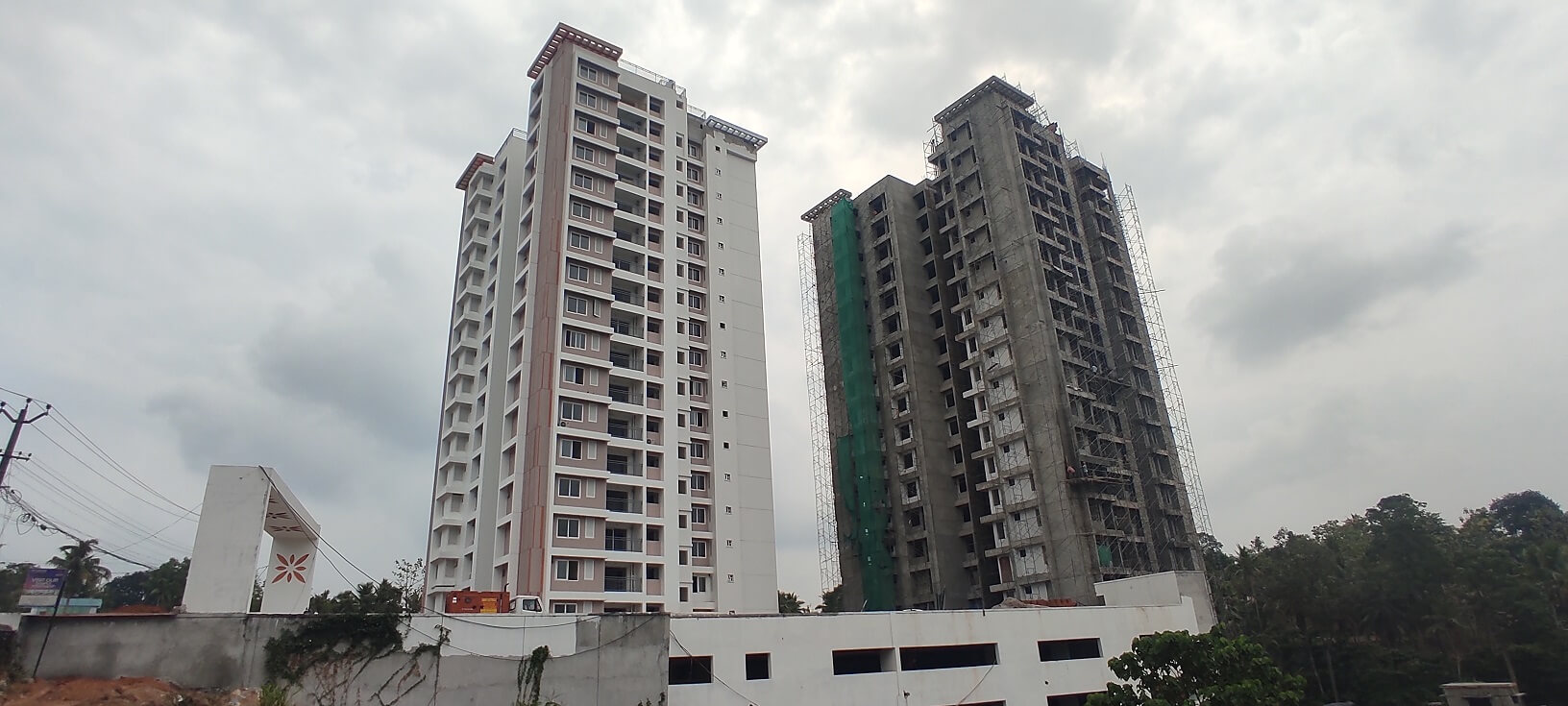

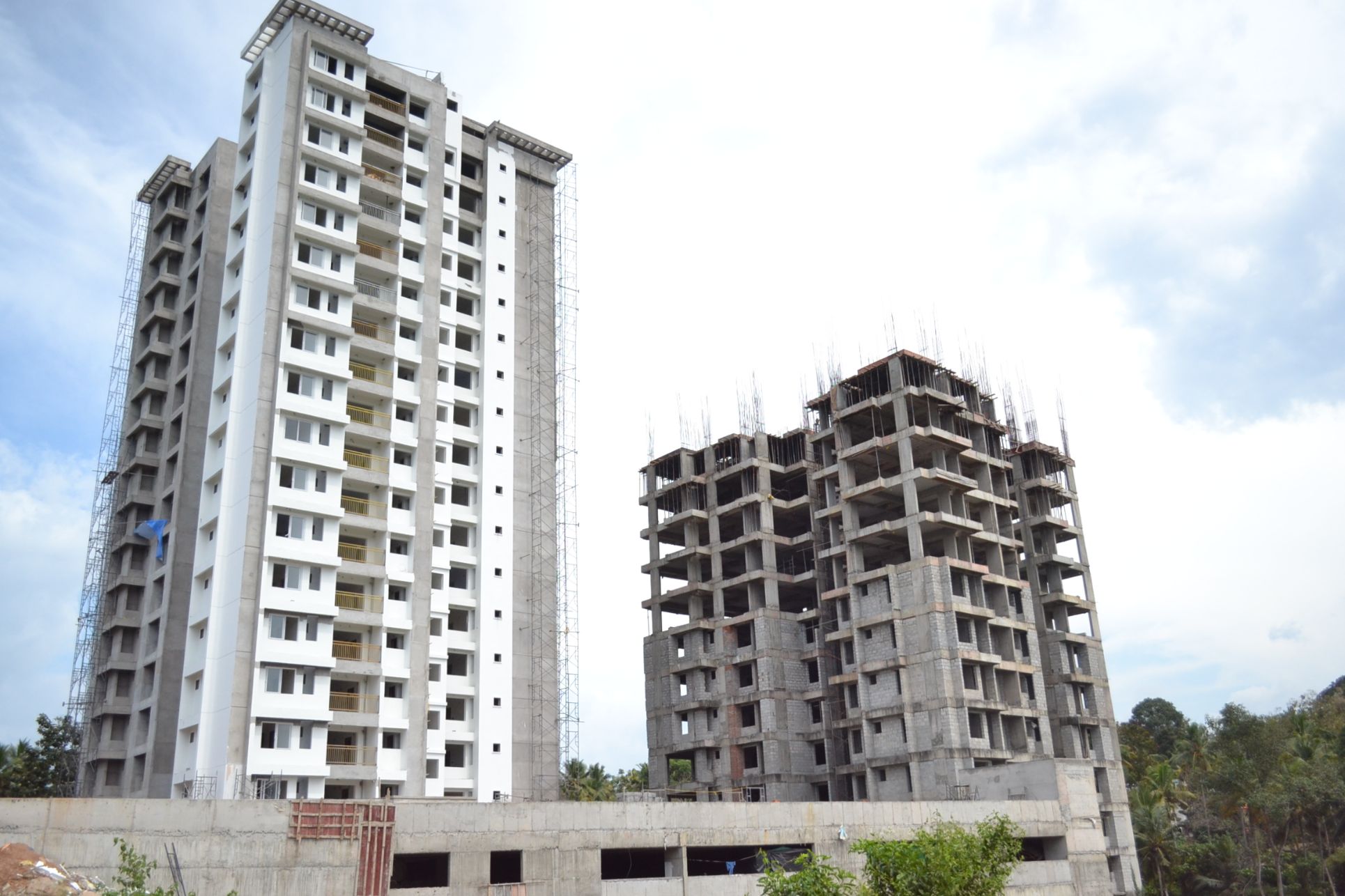

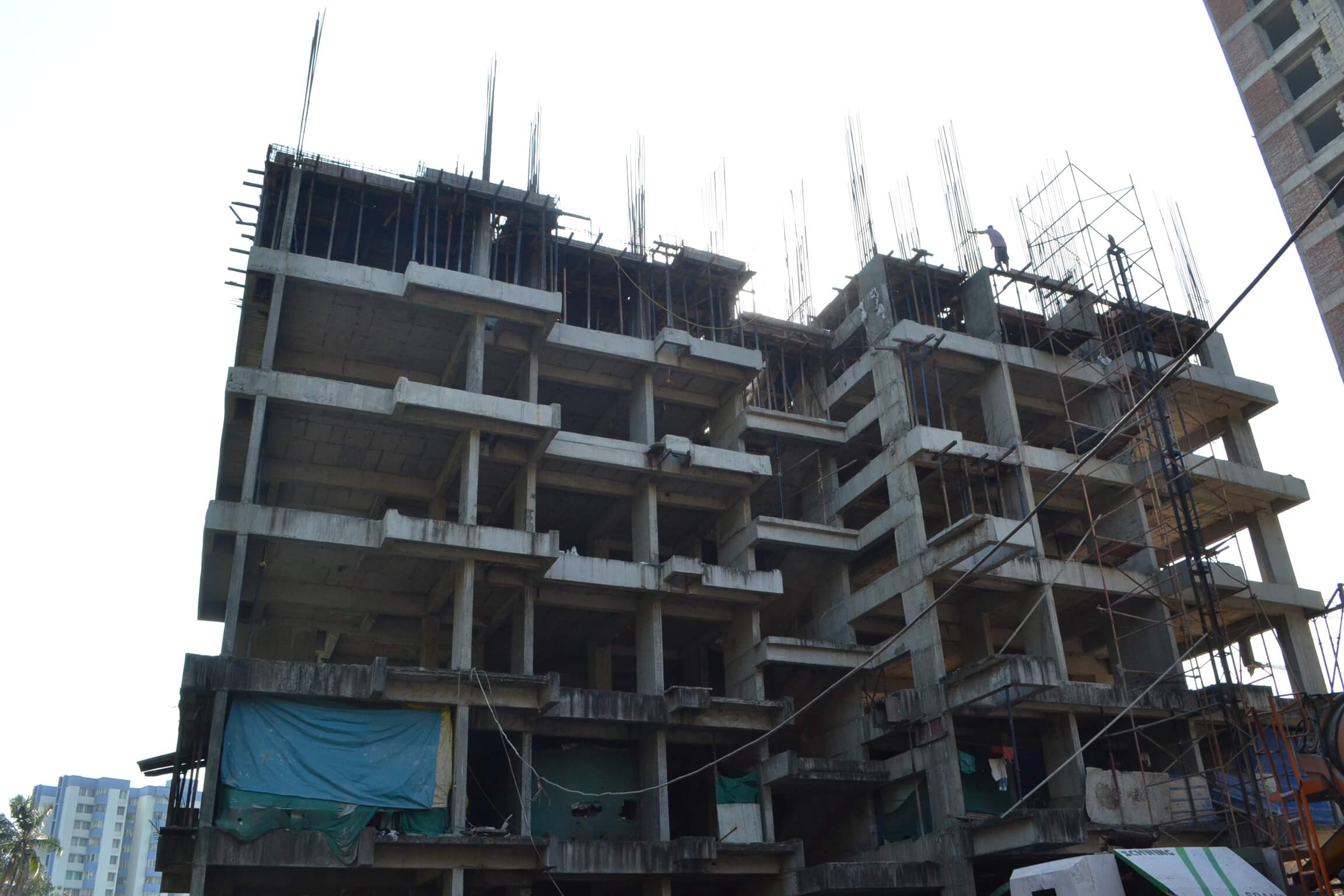

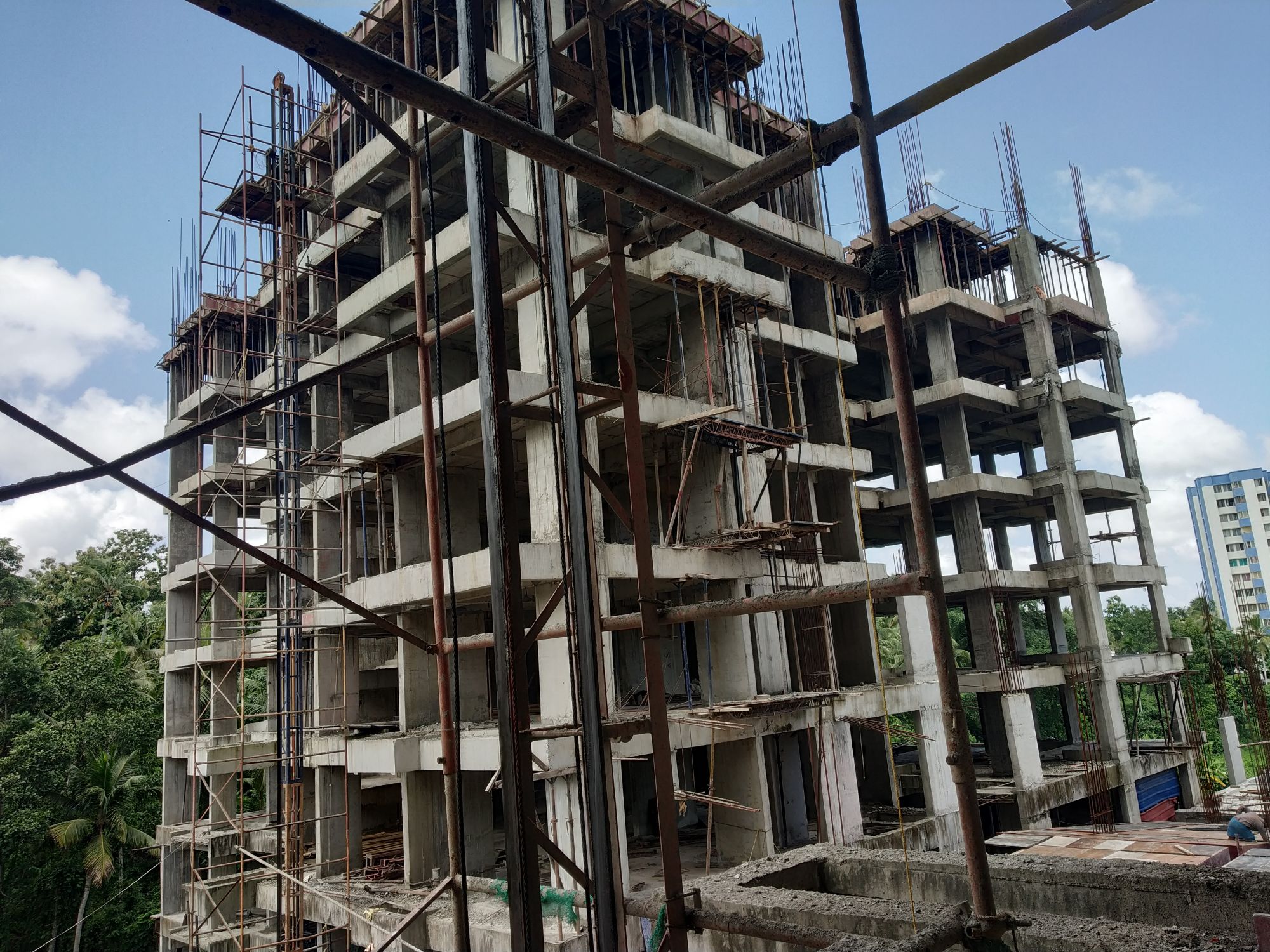

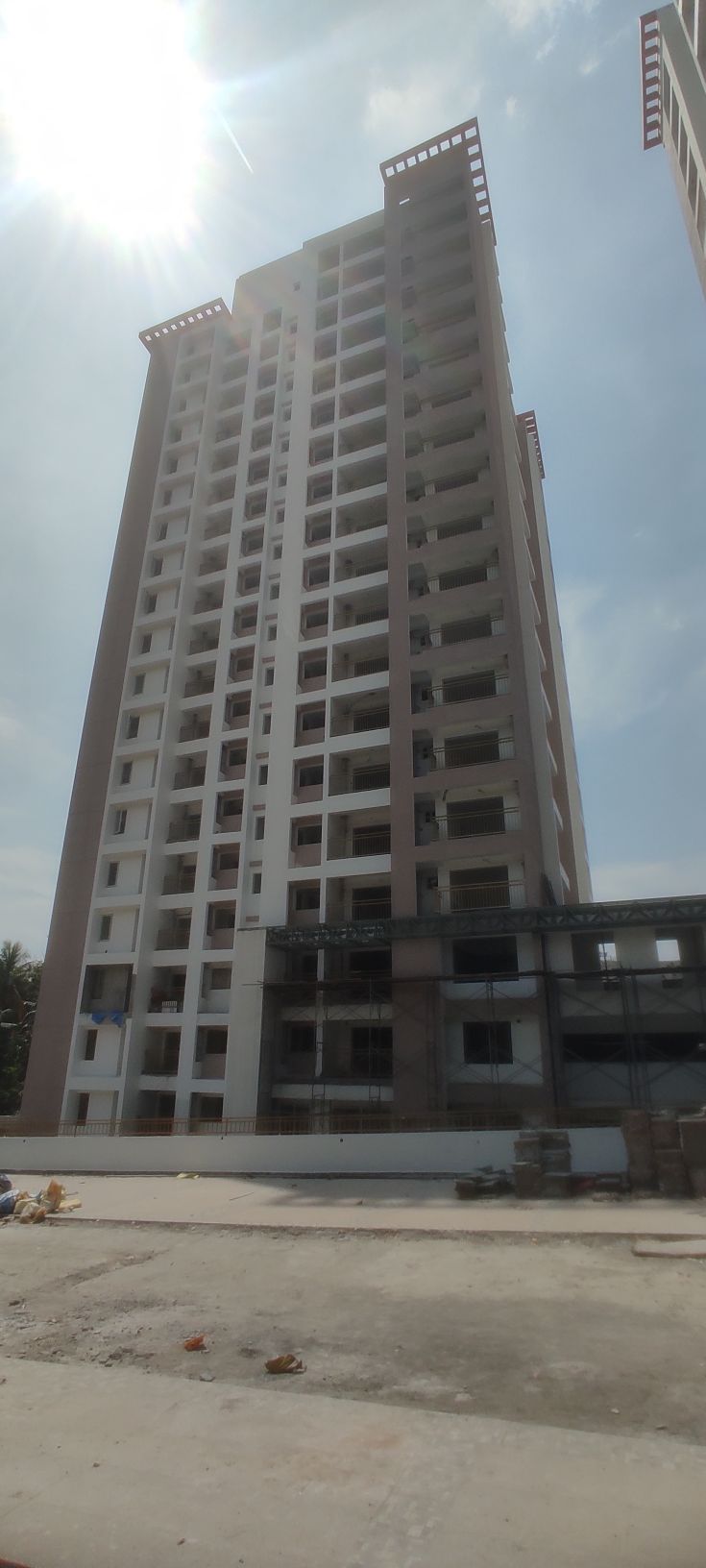

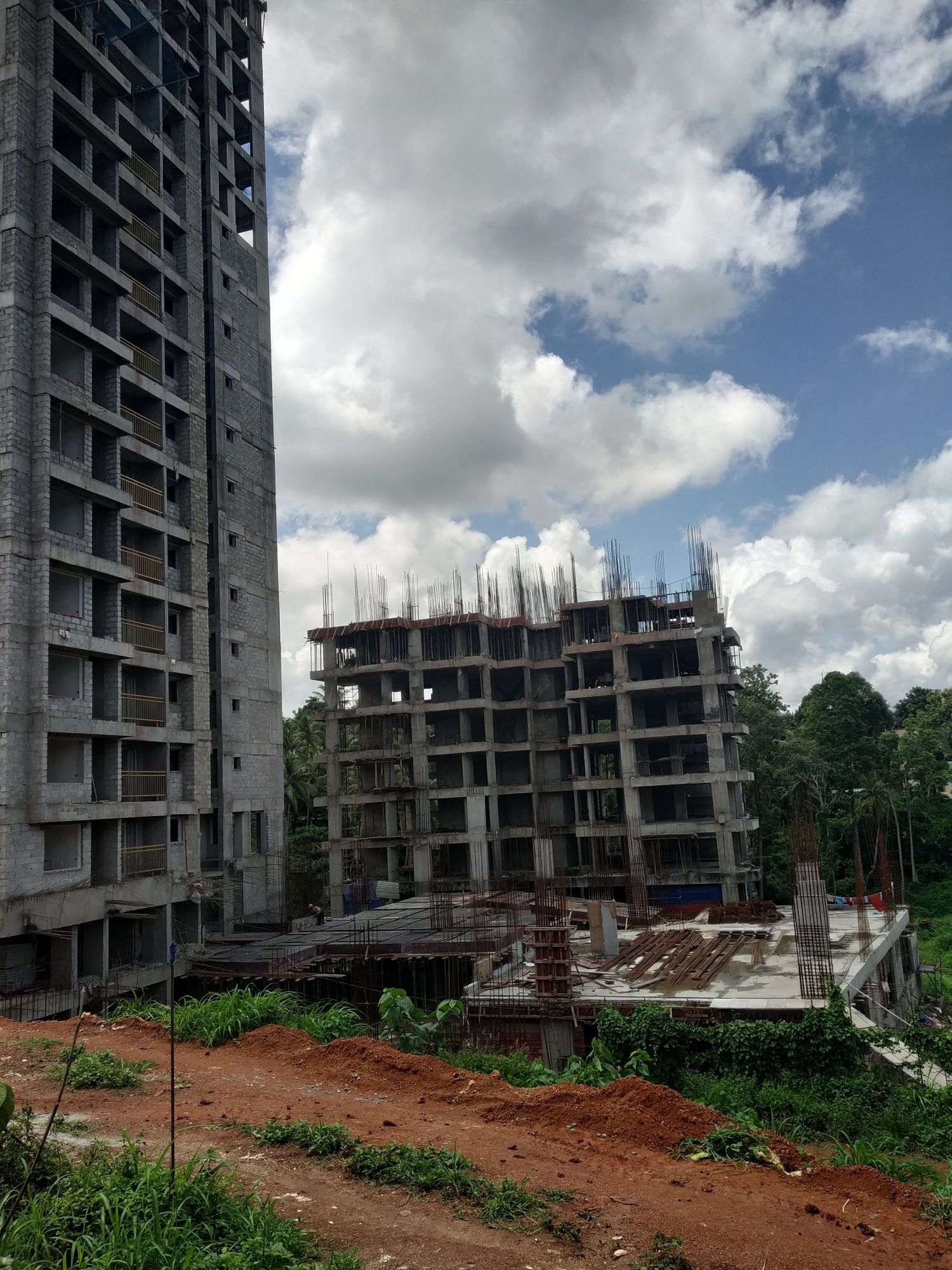

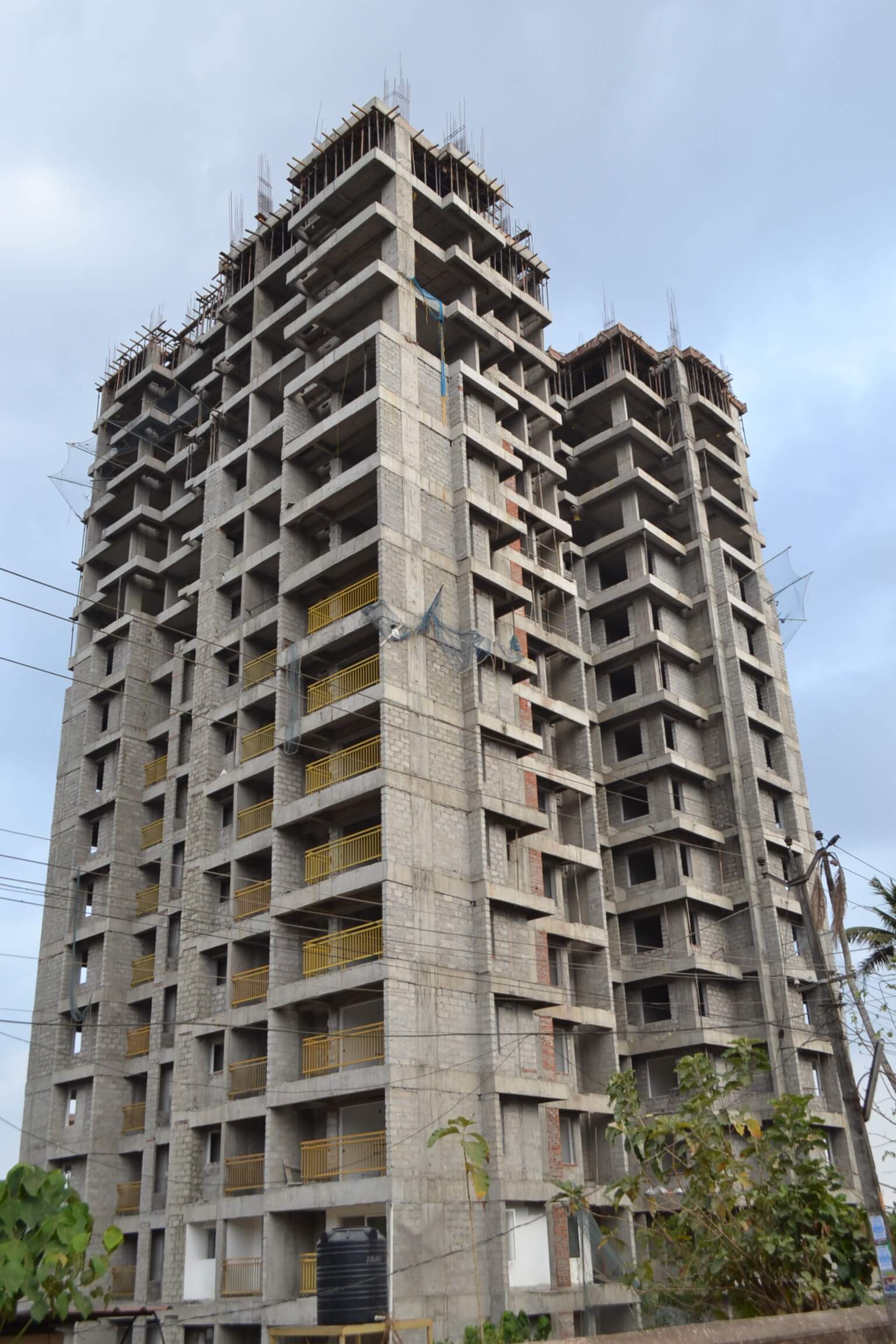

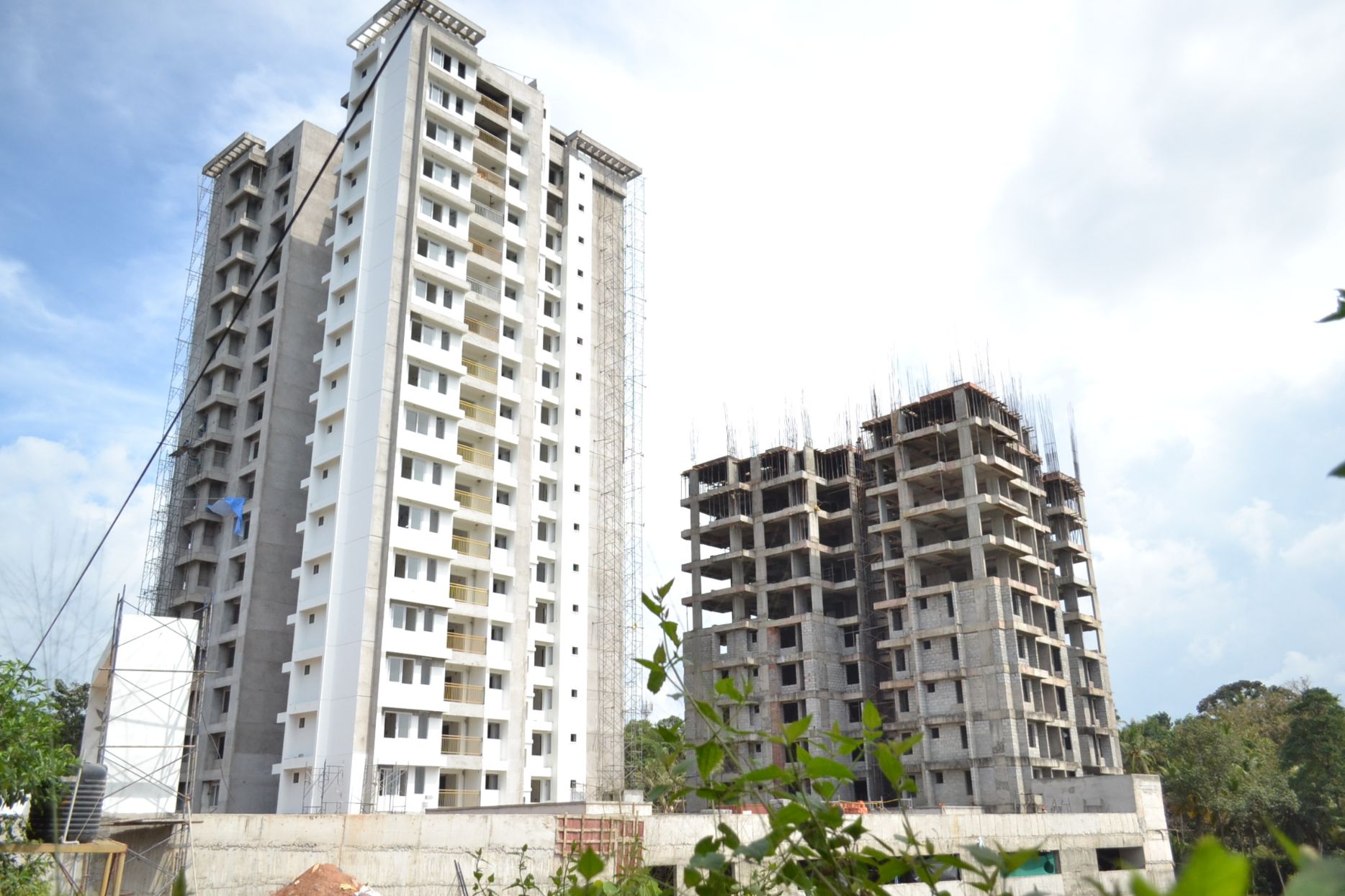

Artech Metropolis - Progress

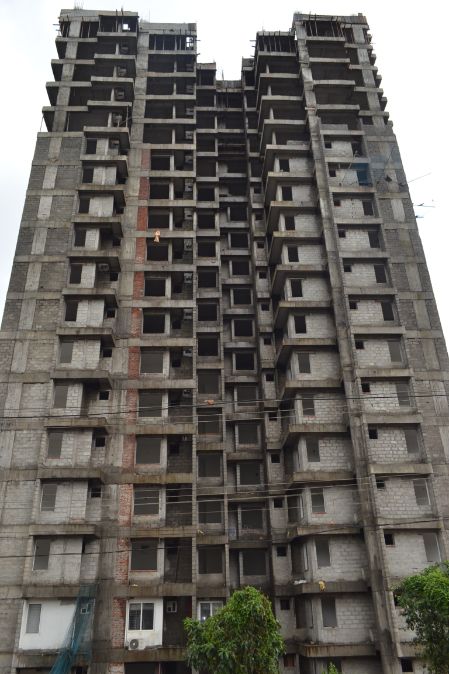

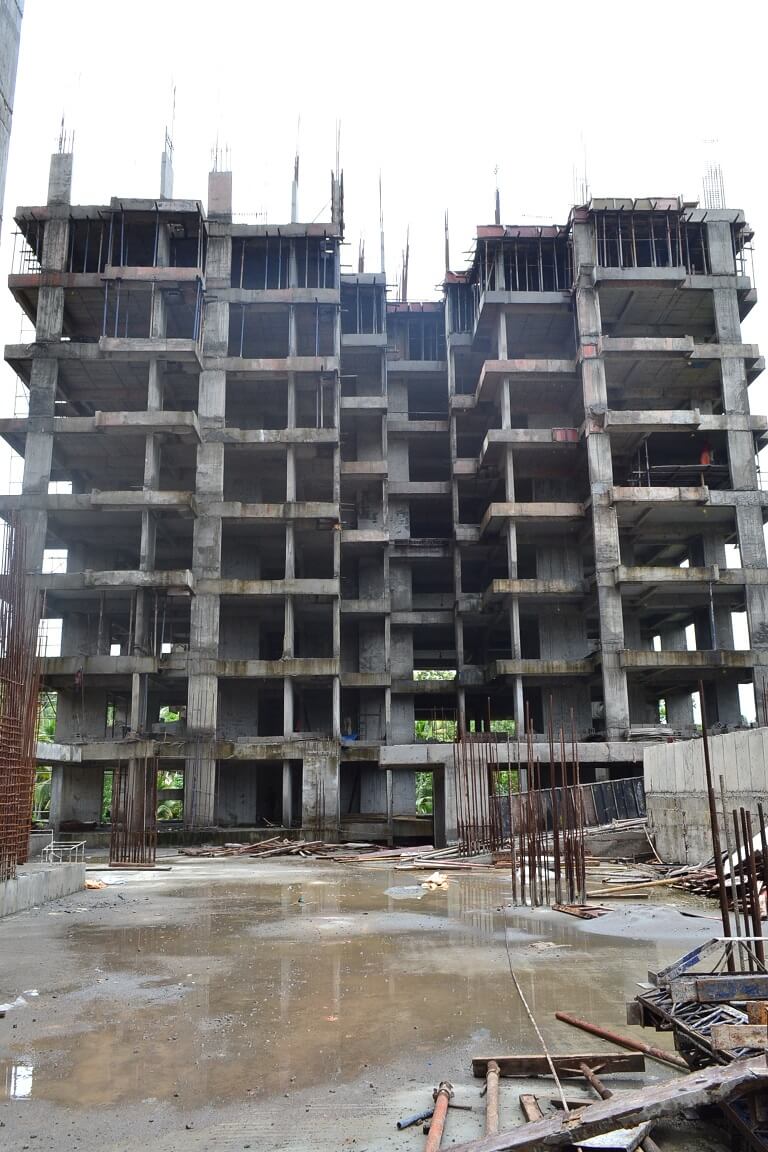

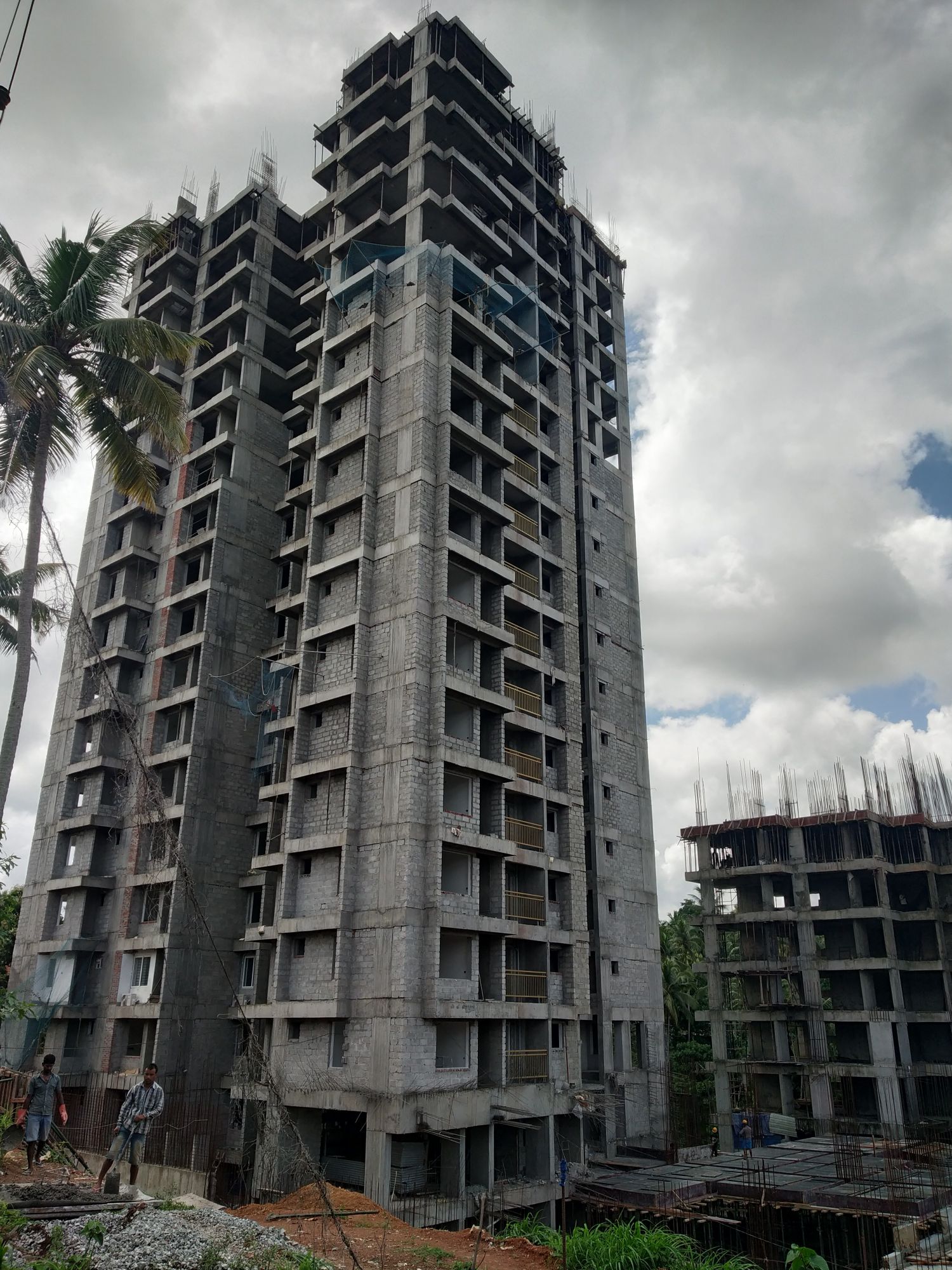

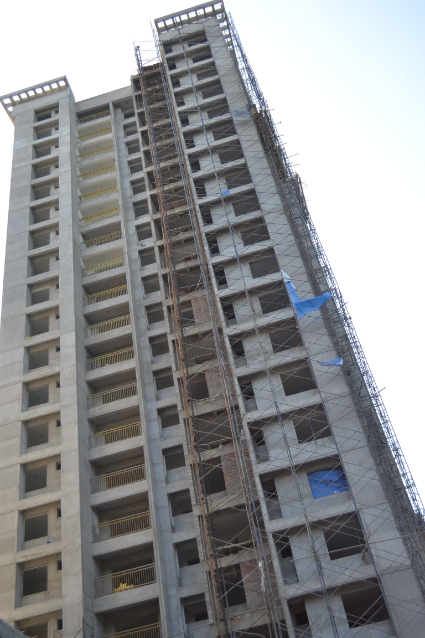

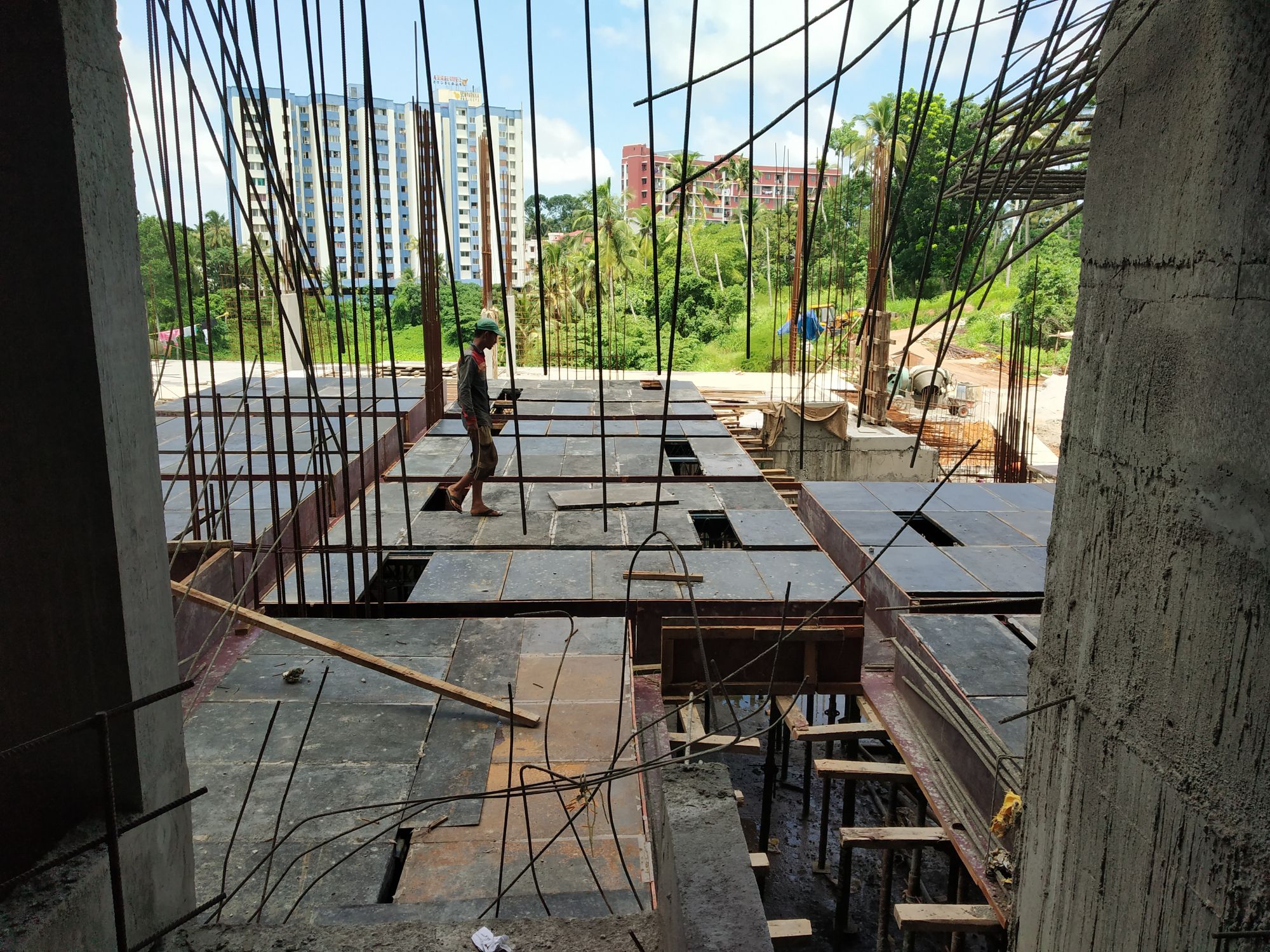

Work status as on 08-03-2023, we have completed the following.

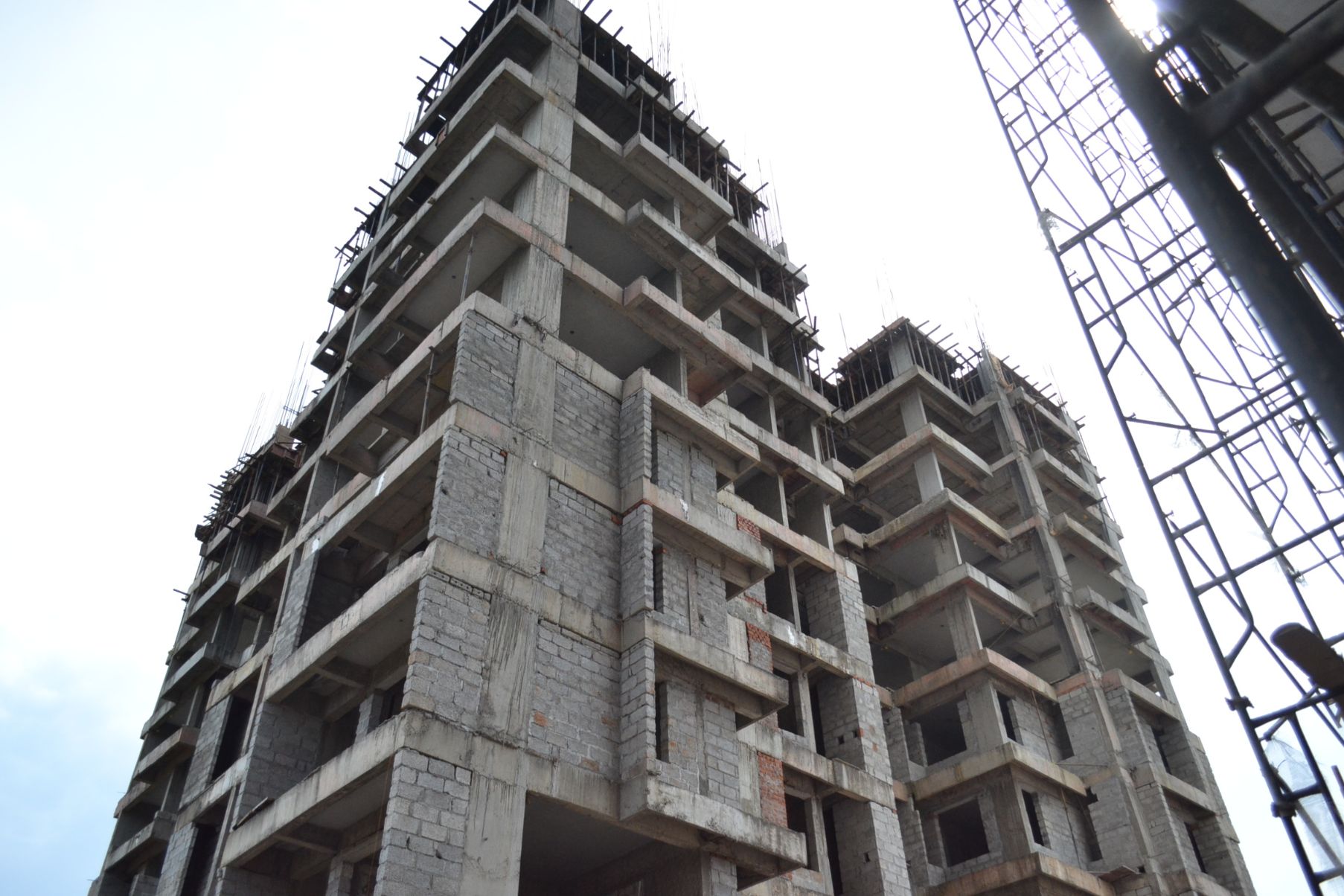

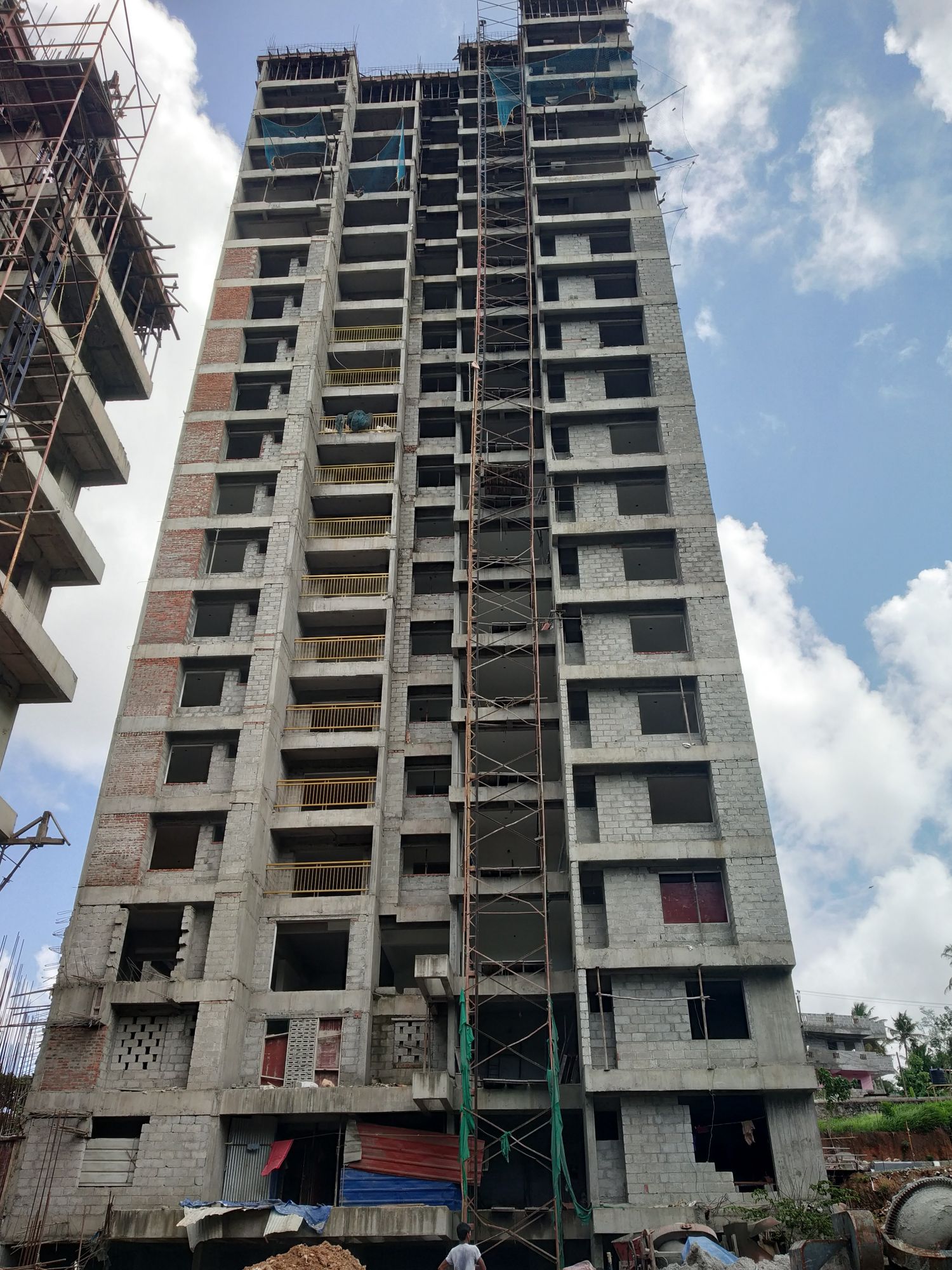

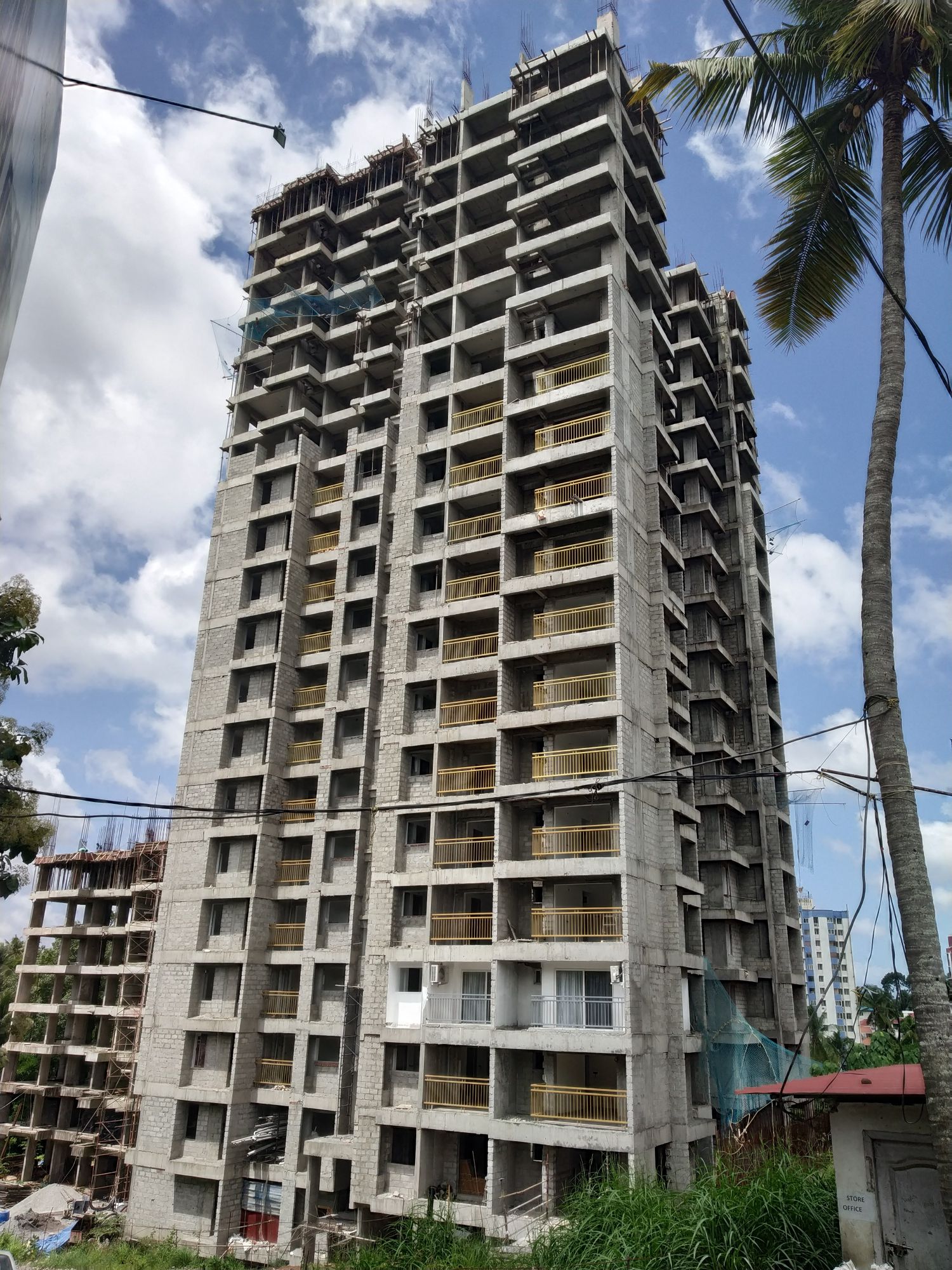

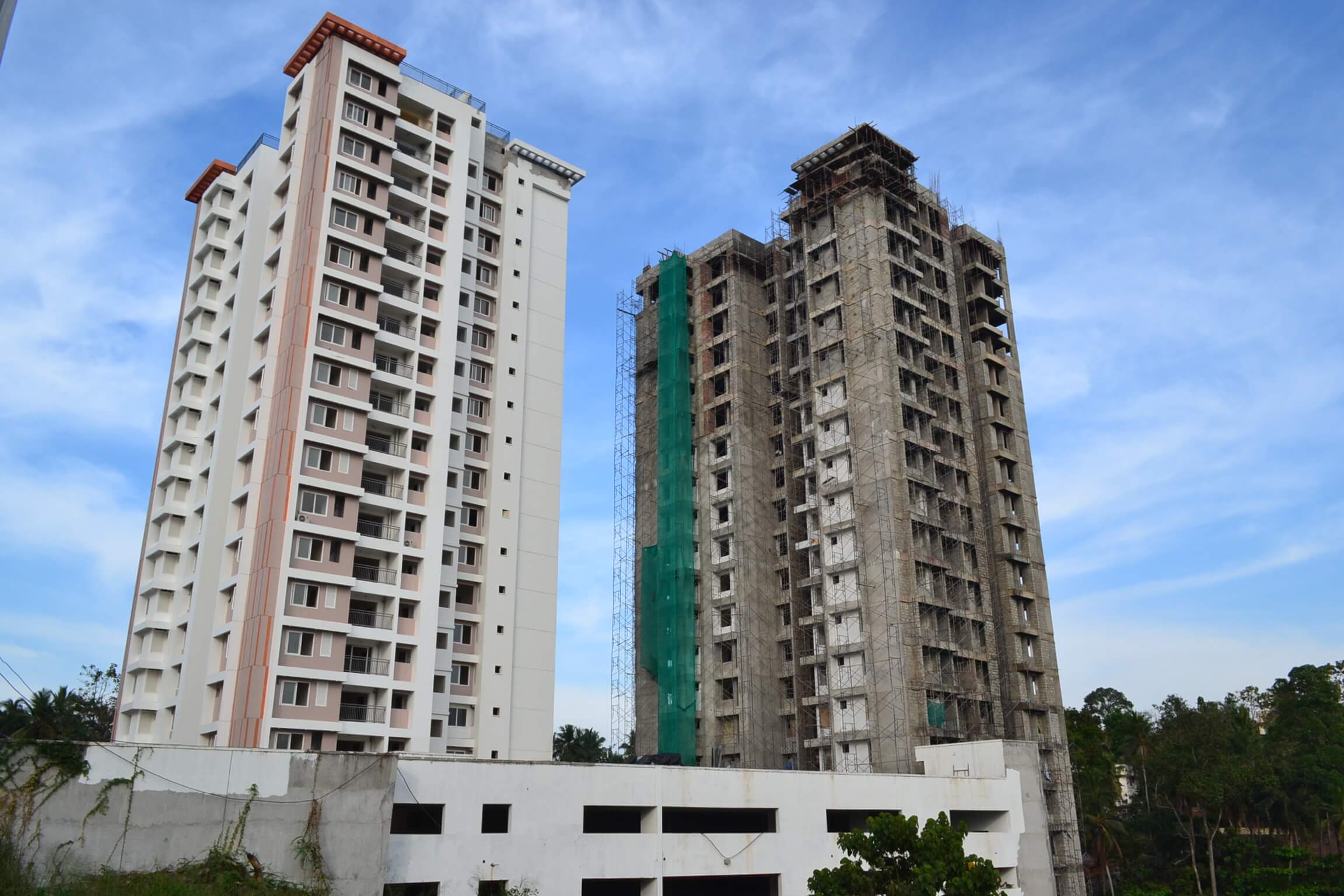

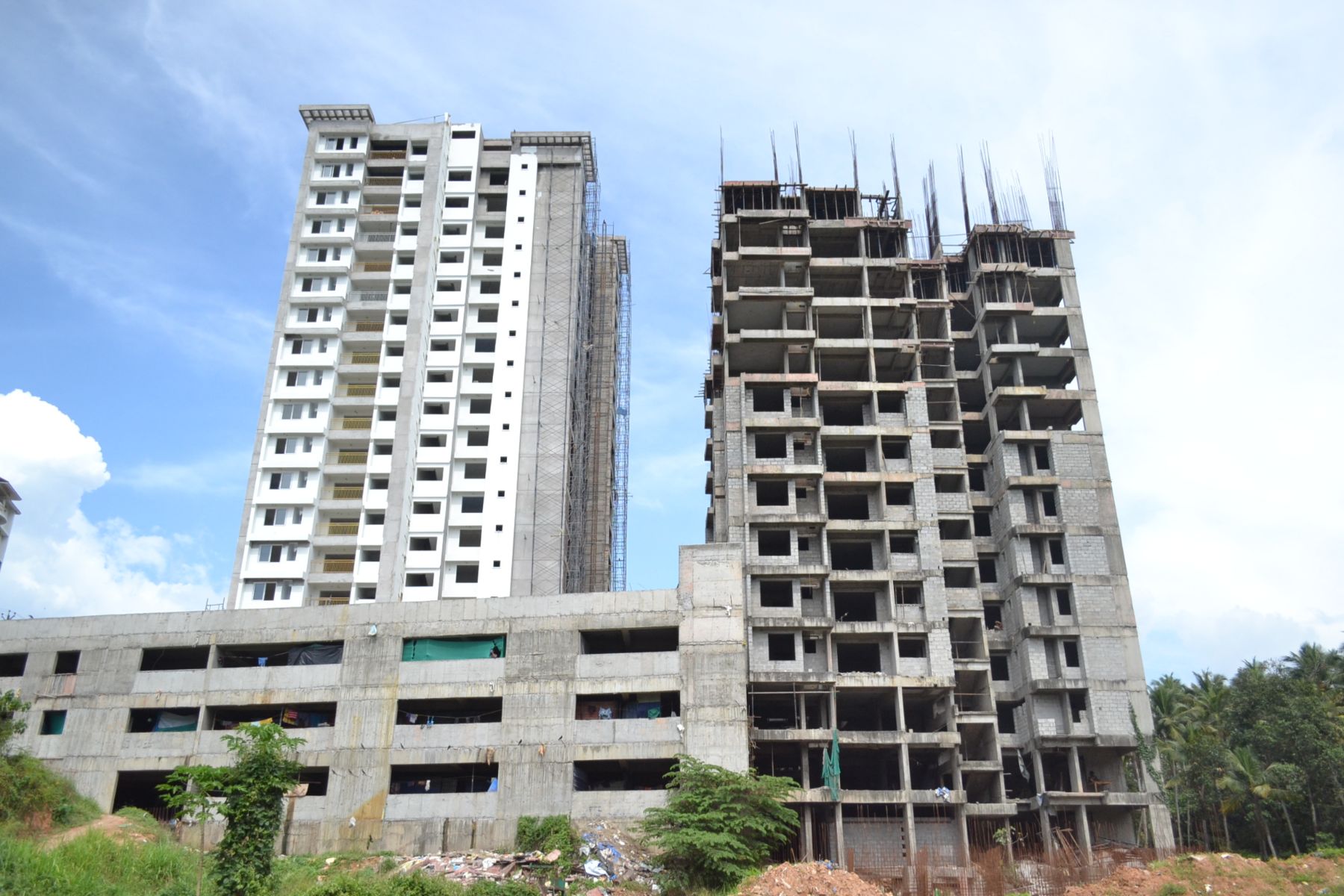

ARTECH METROPOLIS ( TOWER -1 )

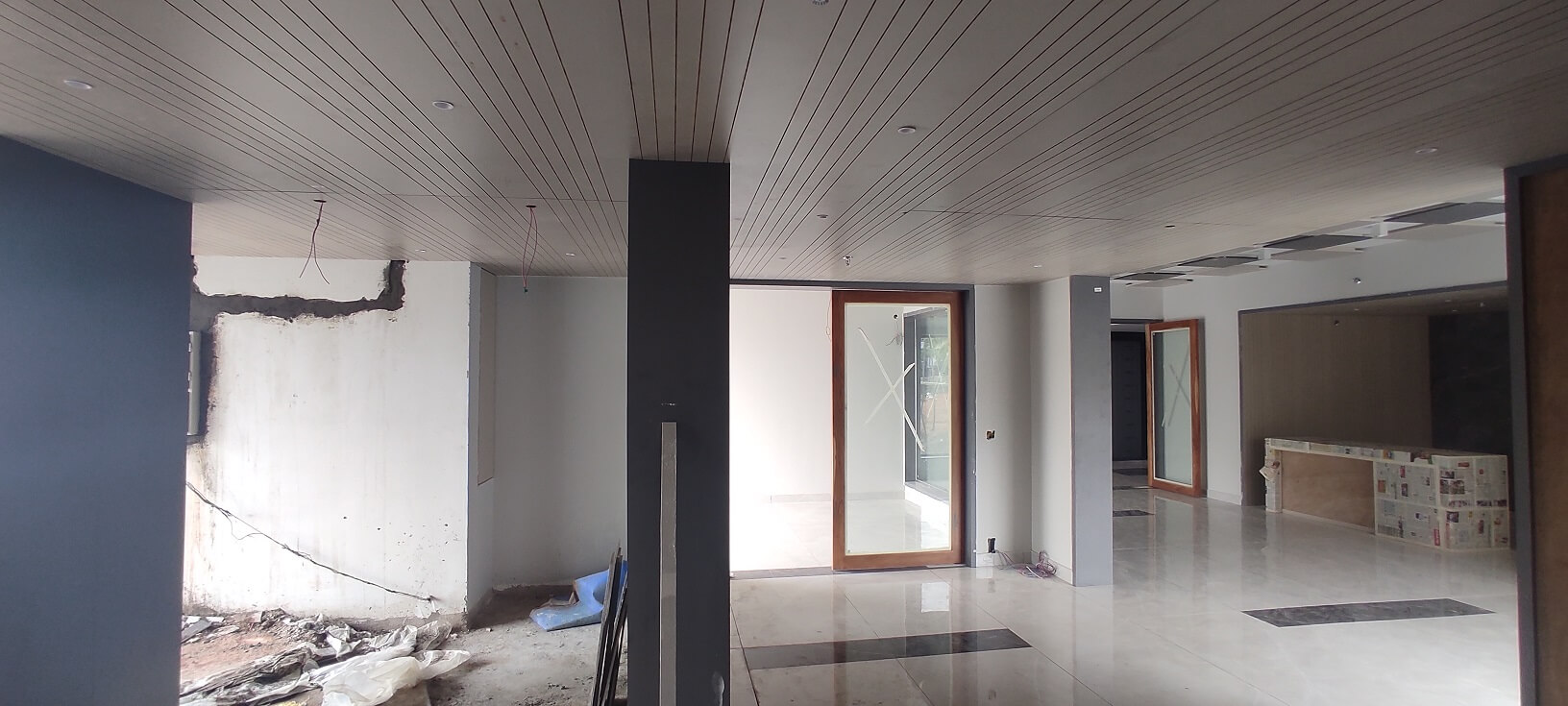

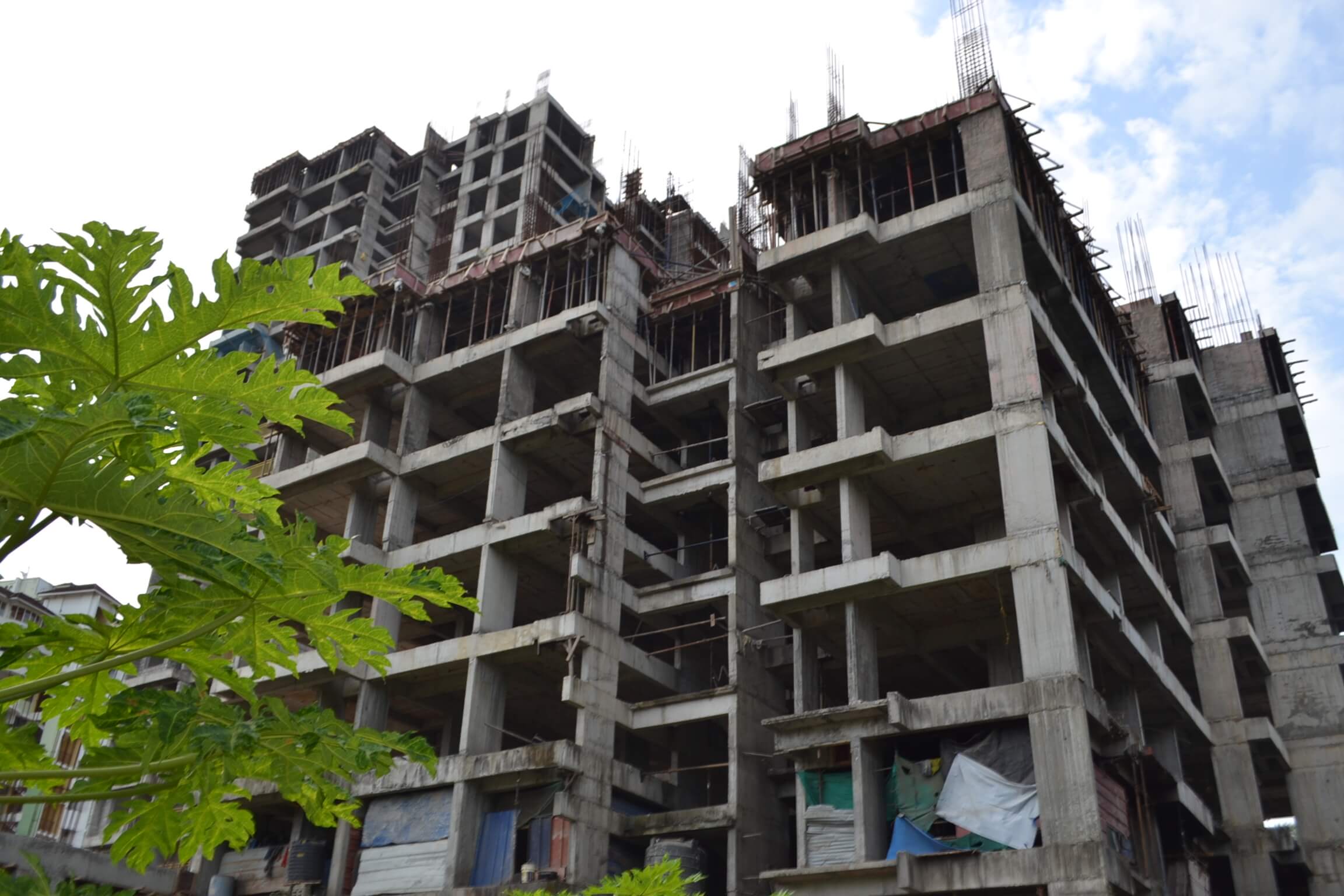

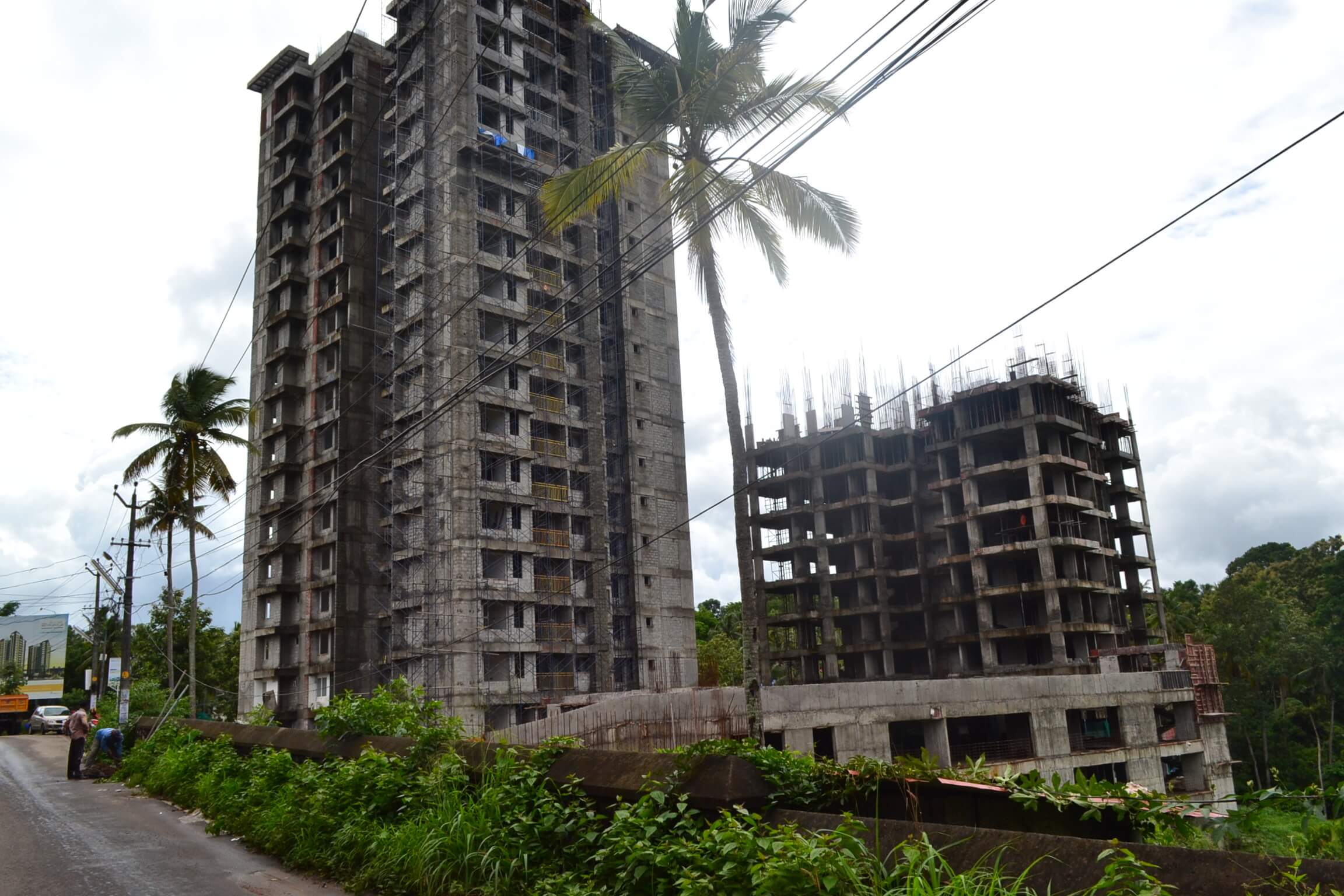

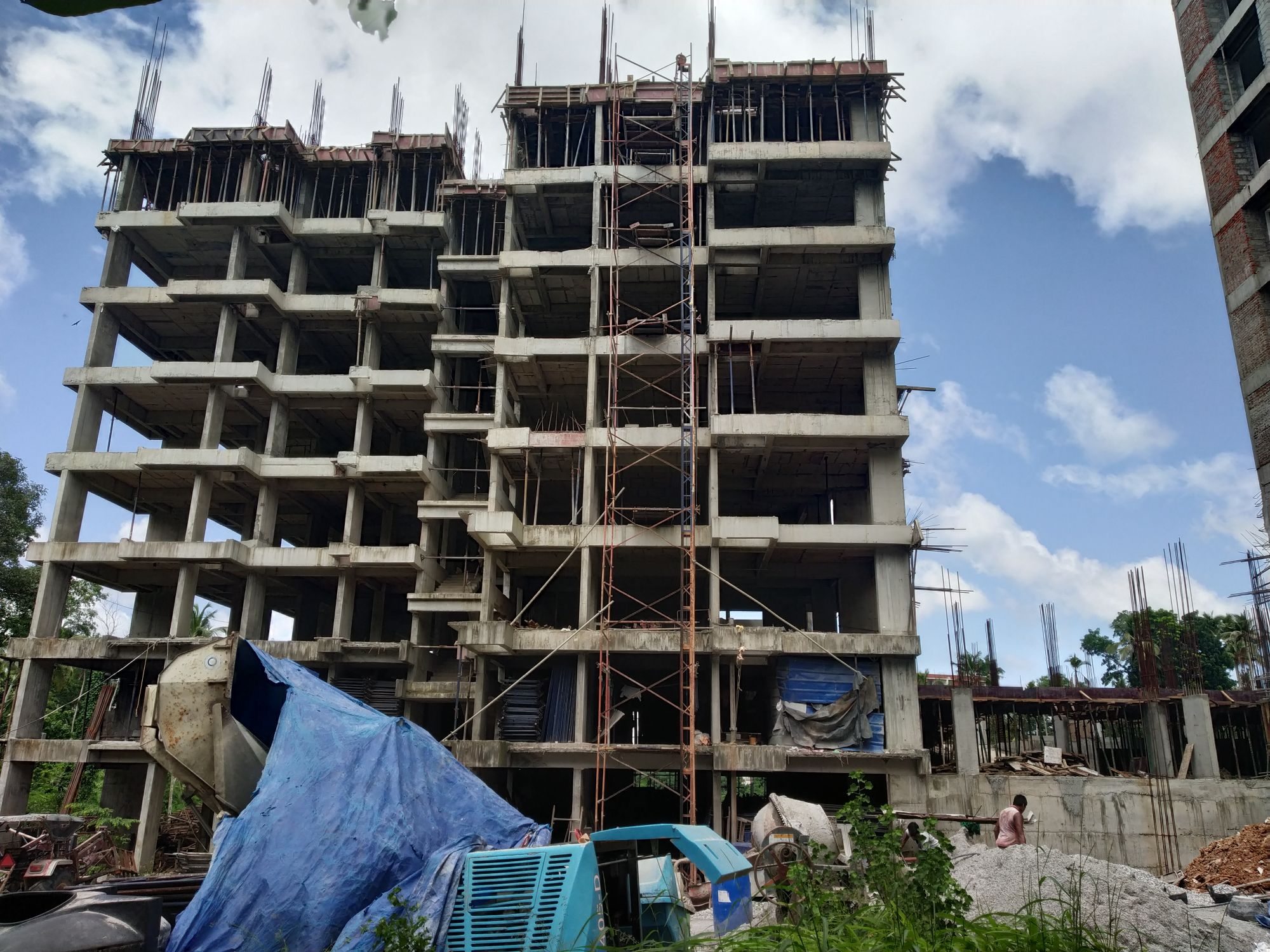

- Structural Works – All sub-structural and structural works- completed

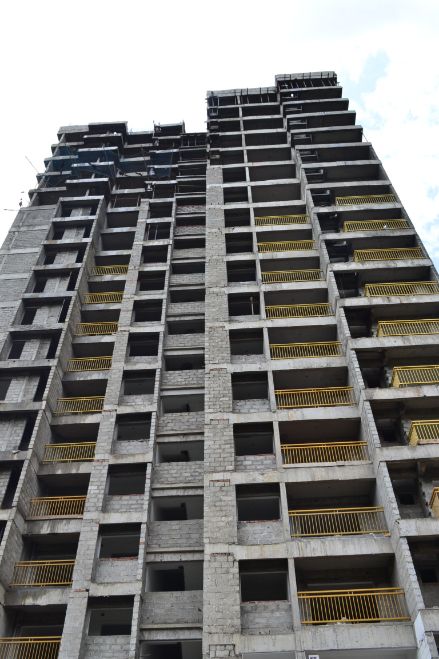

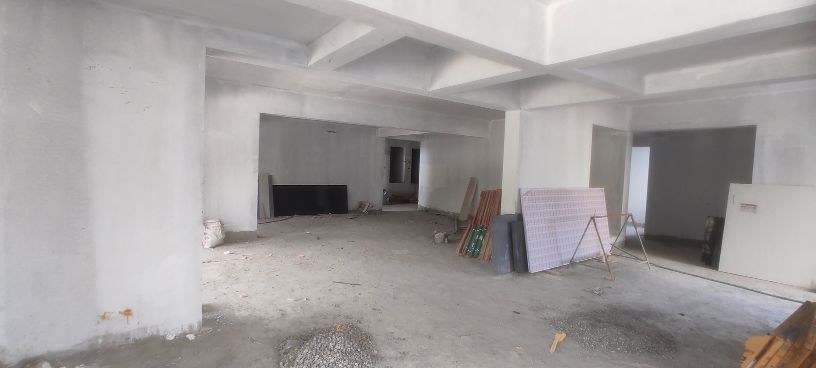

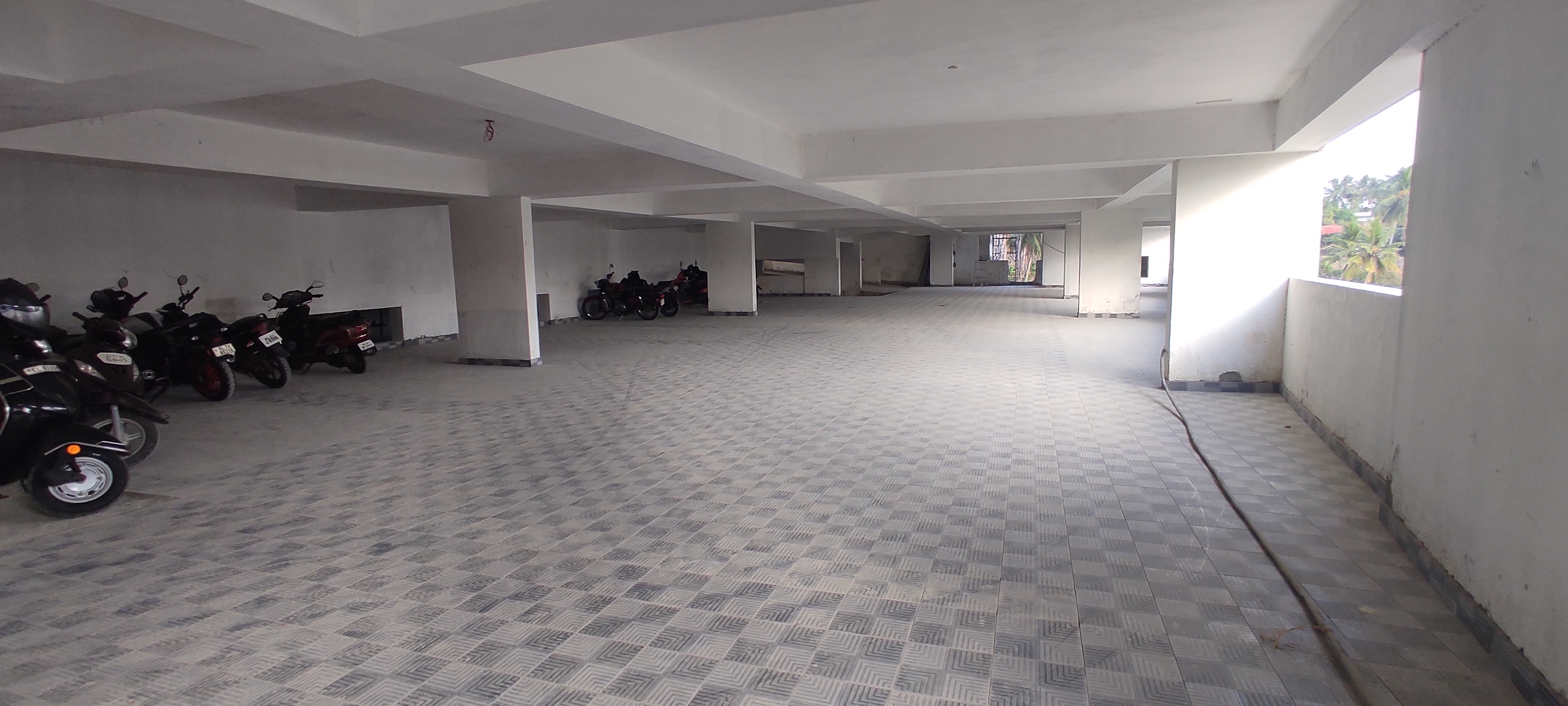

- Civil Works – Completed

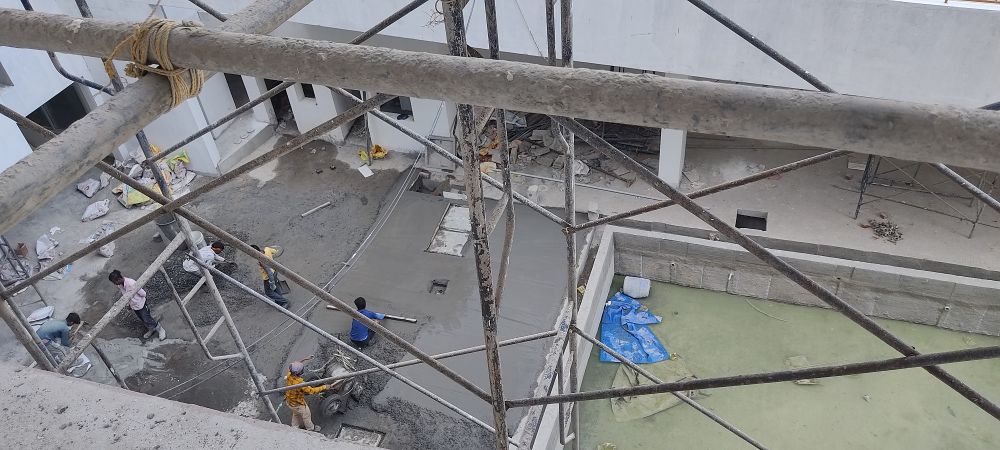

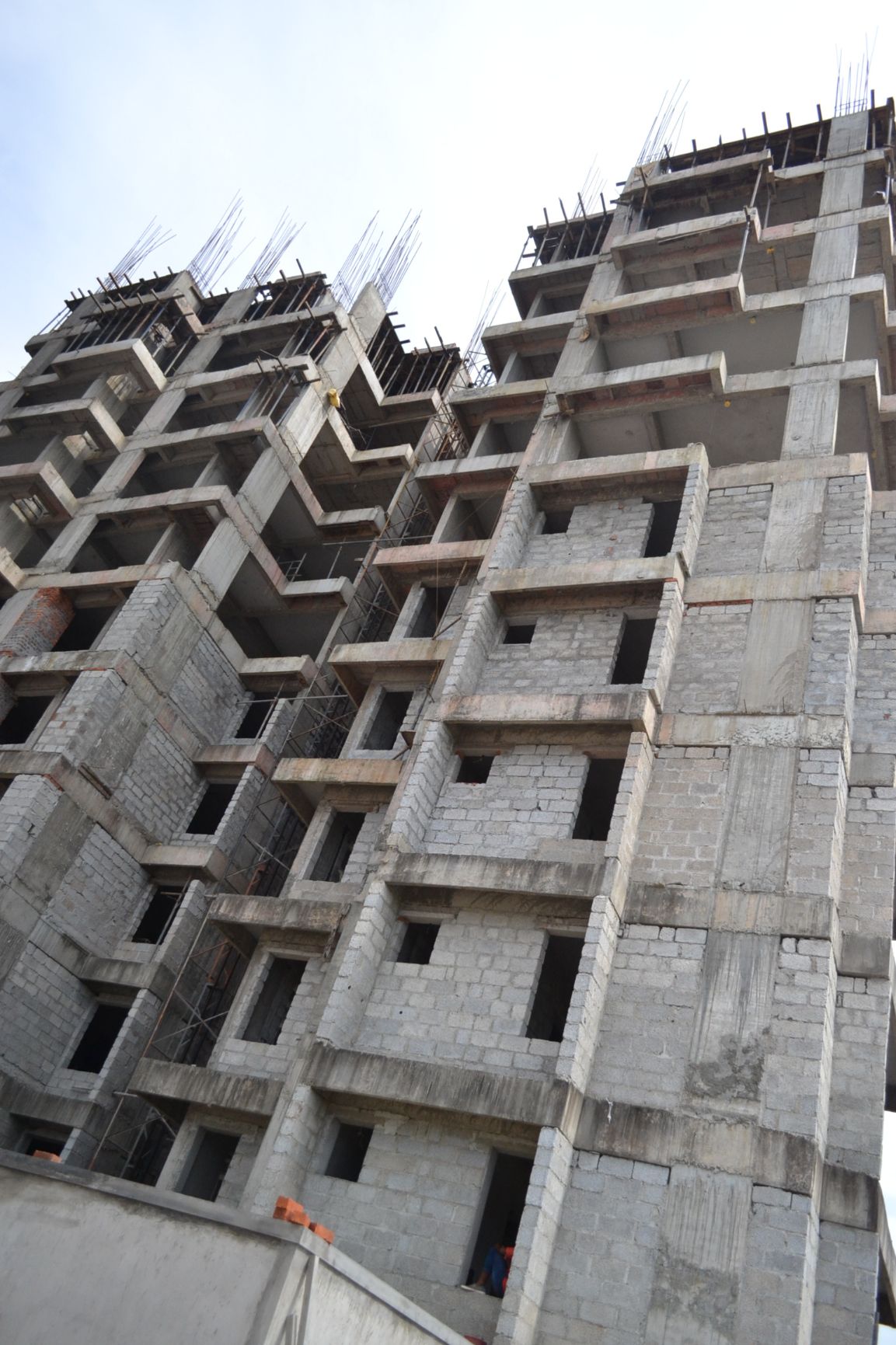

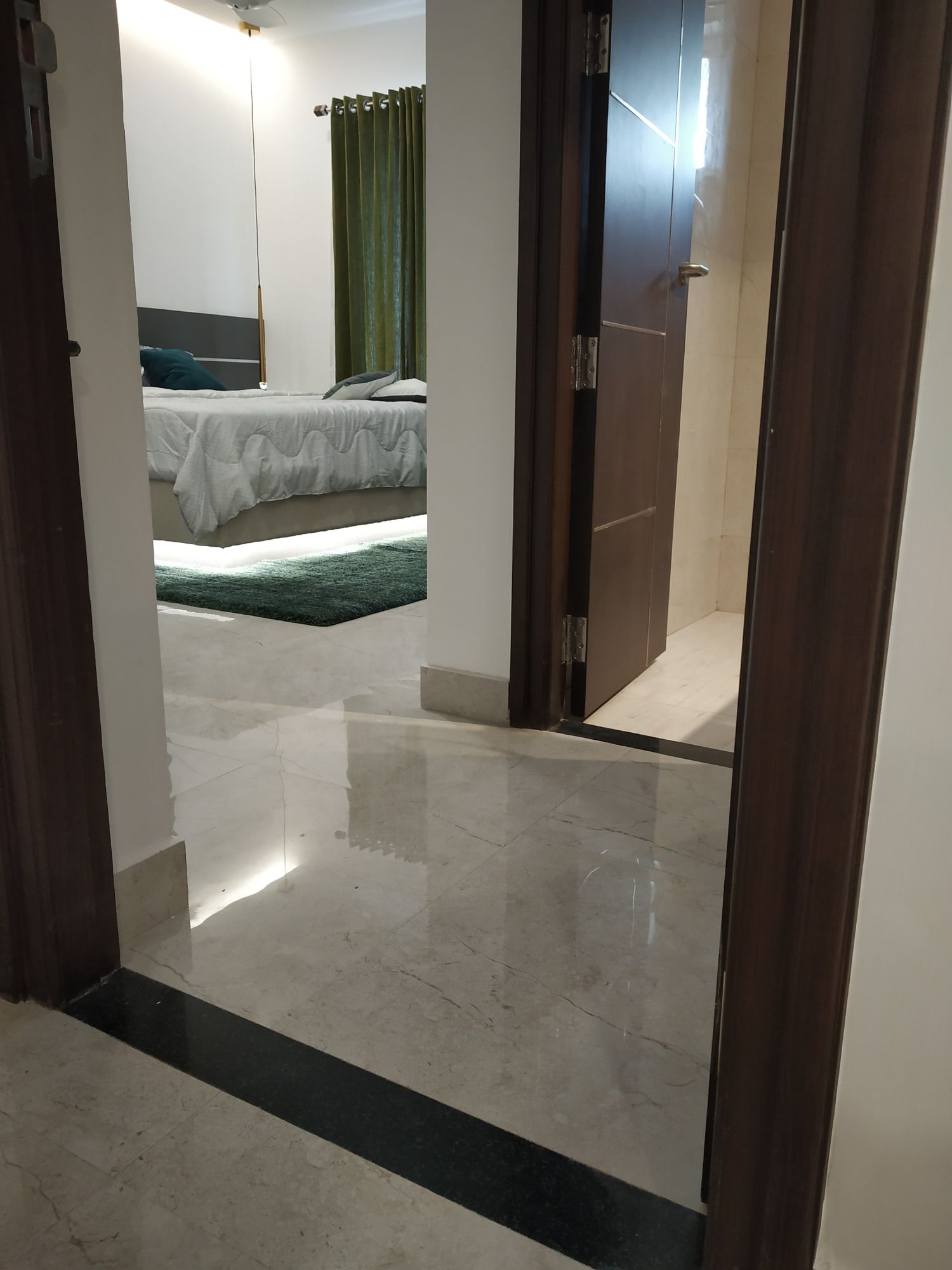

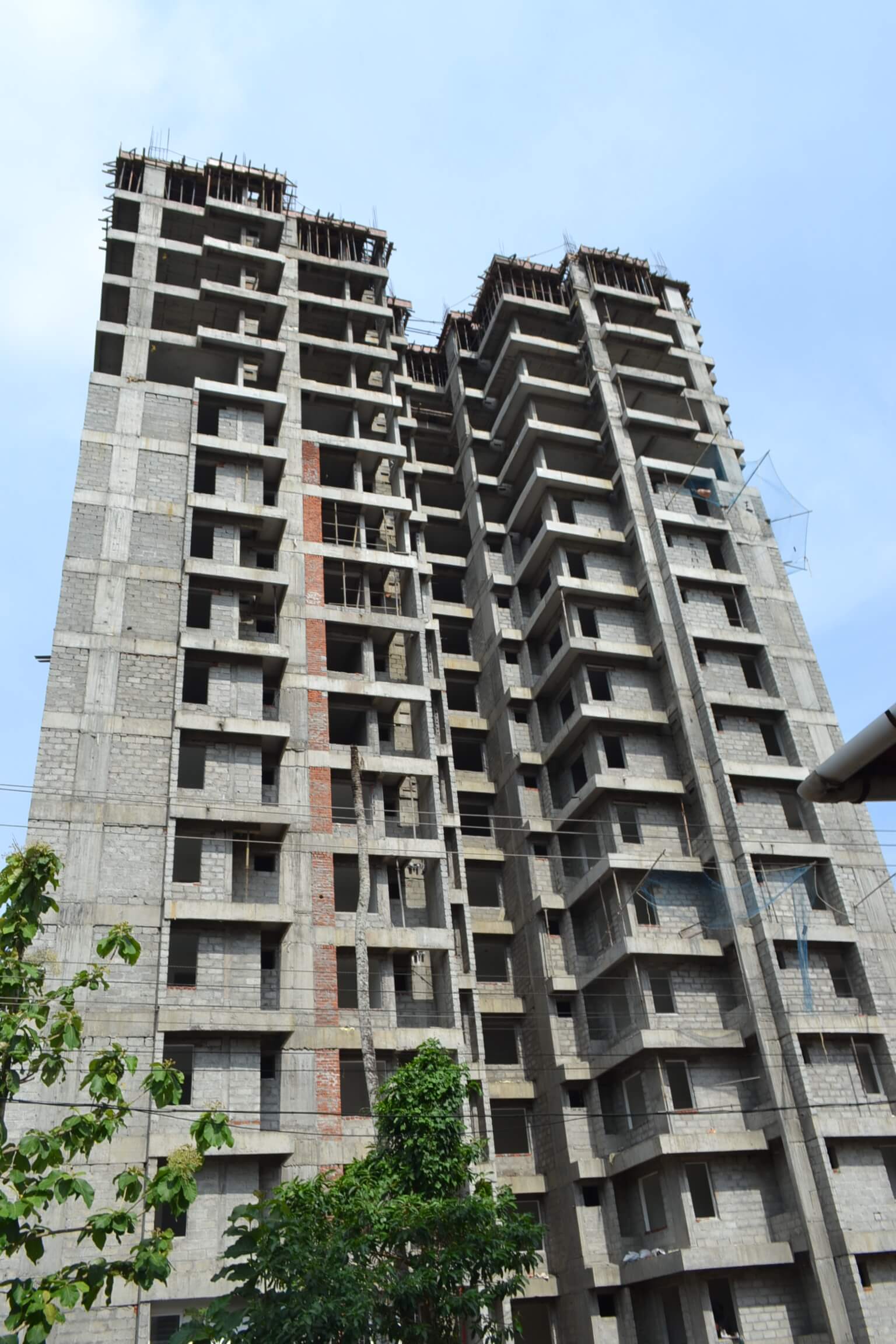

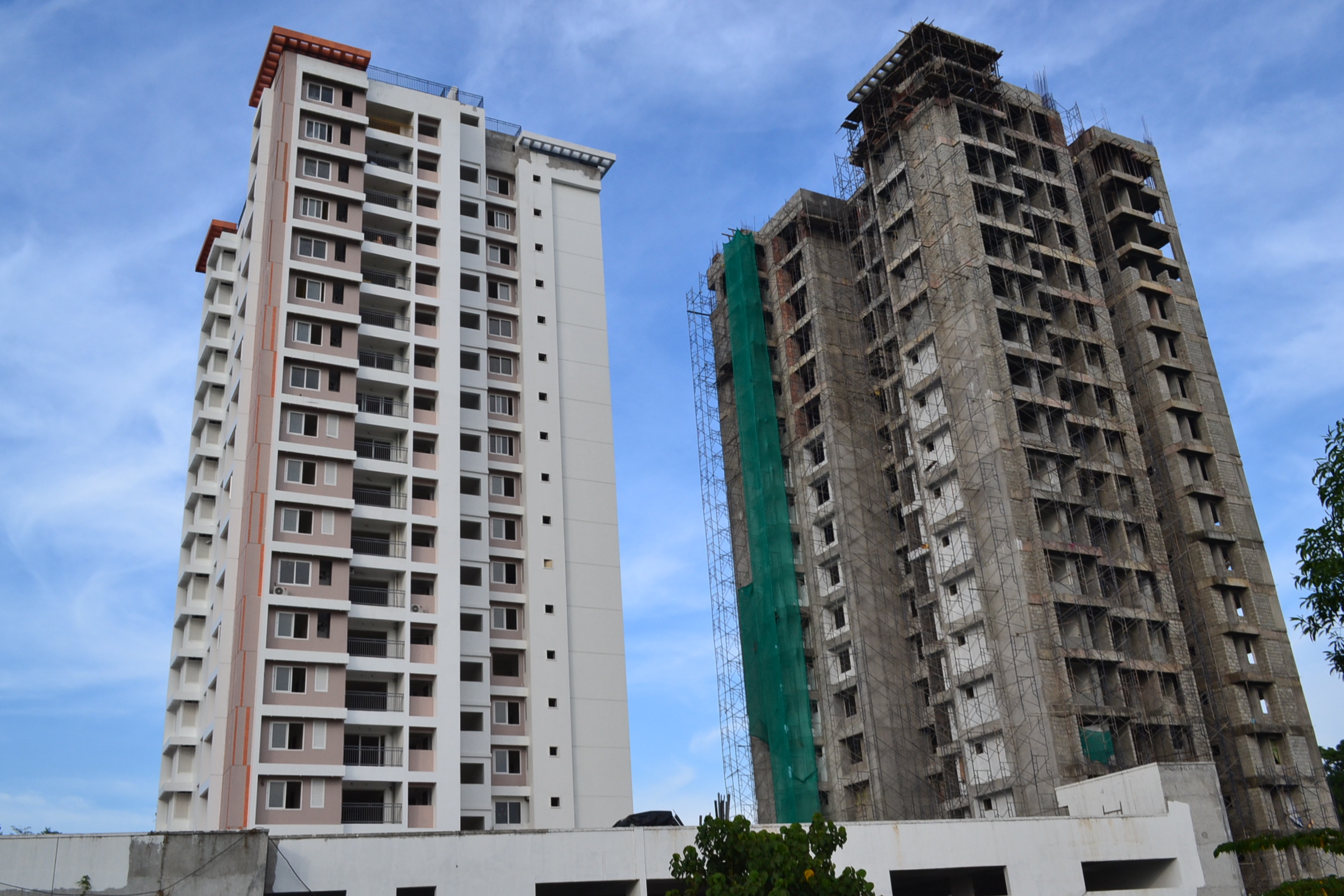

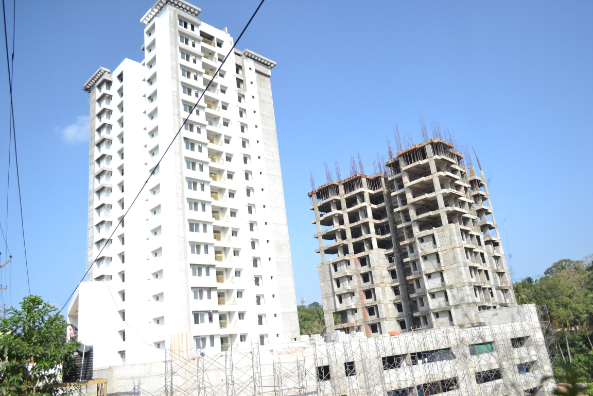

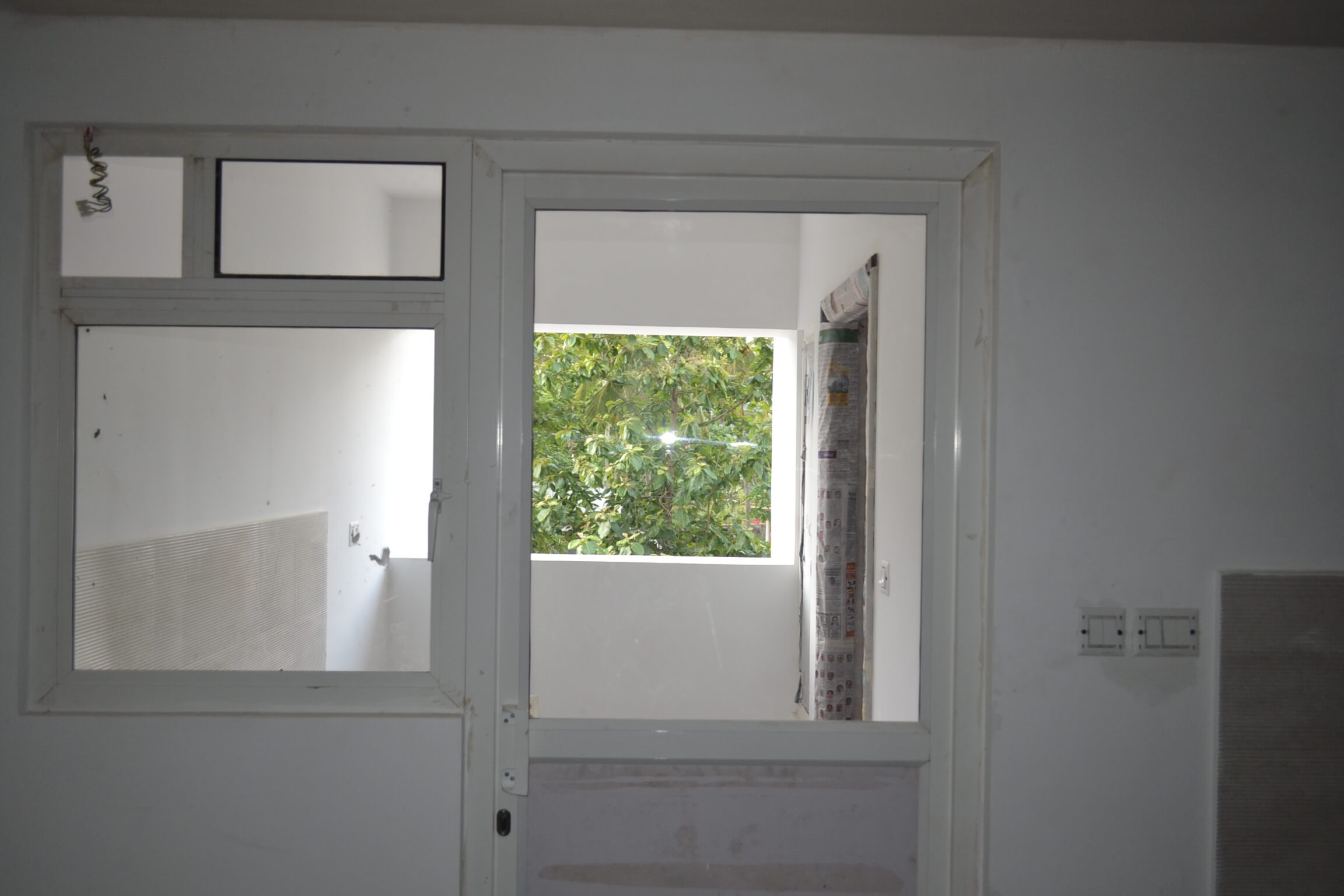

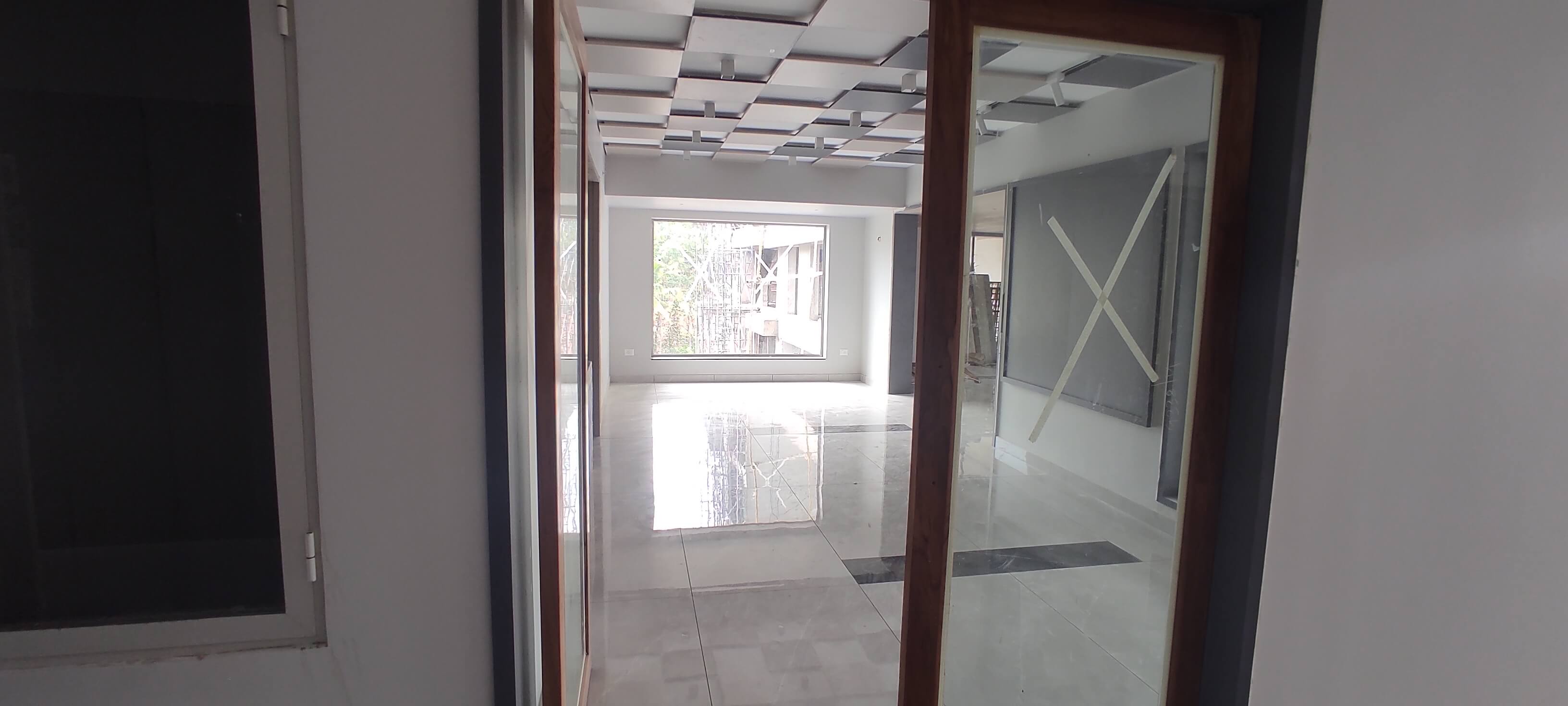

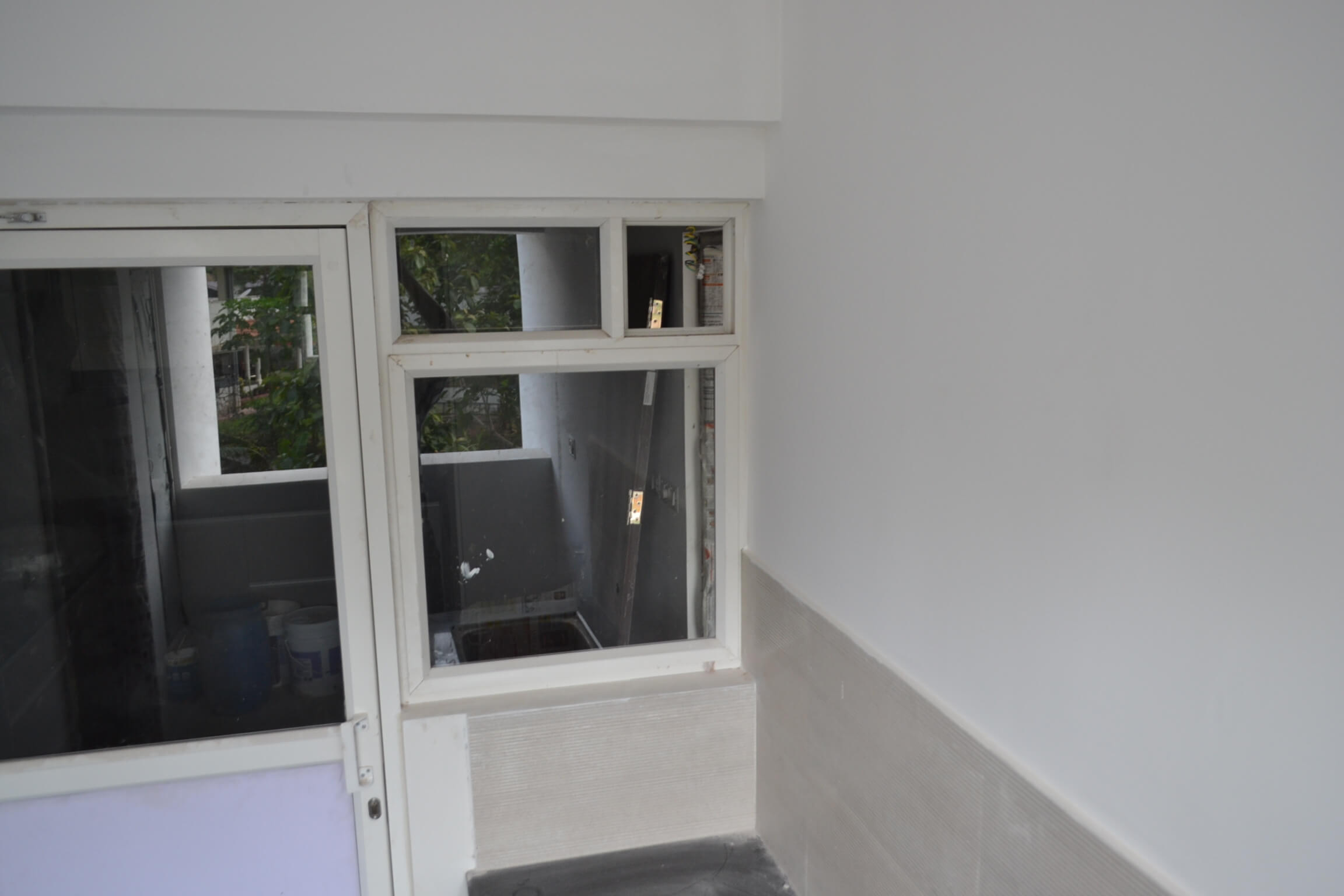

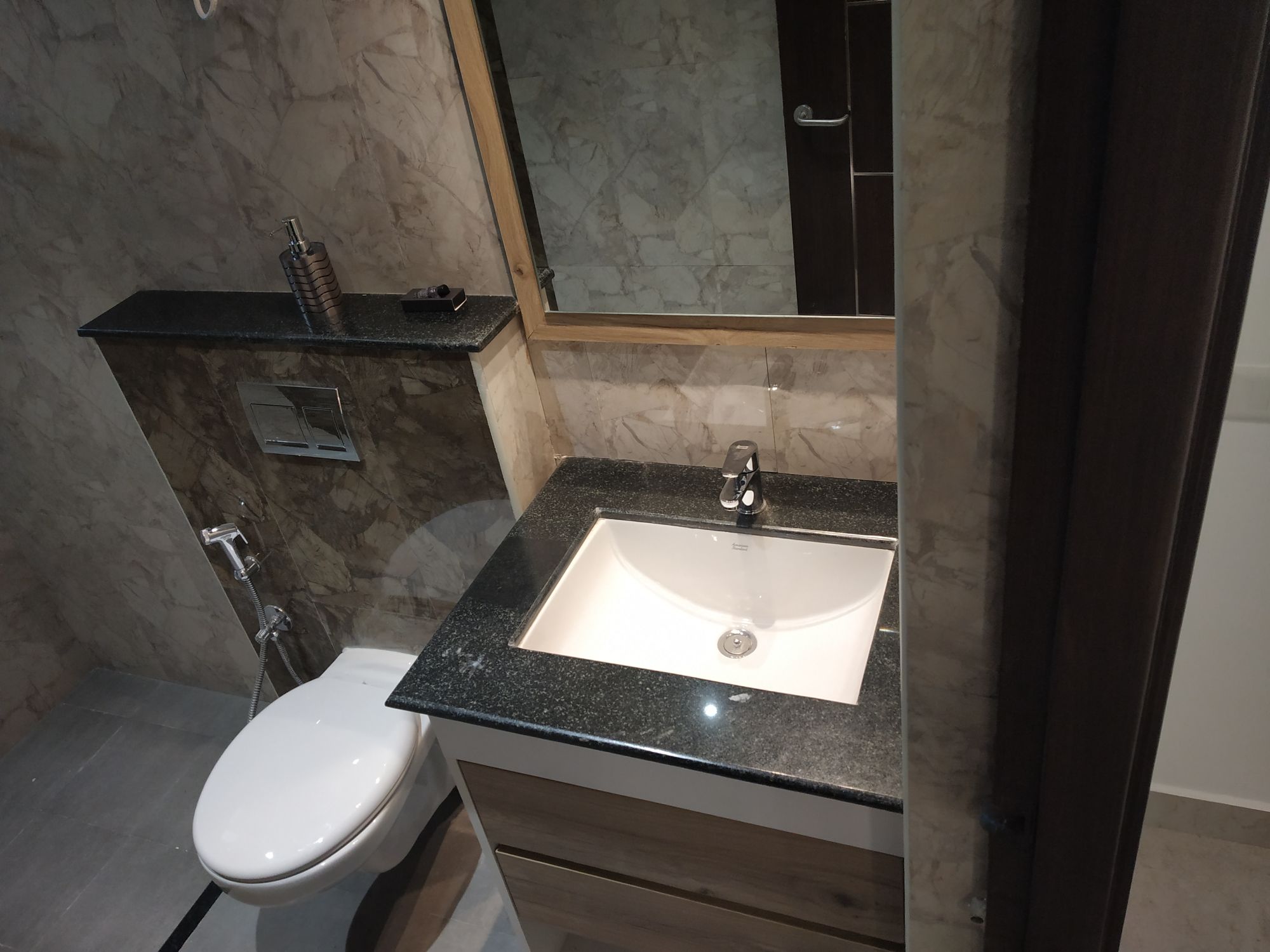

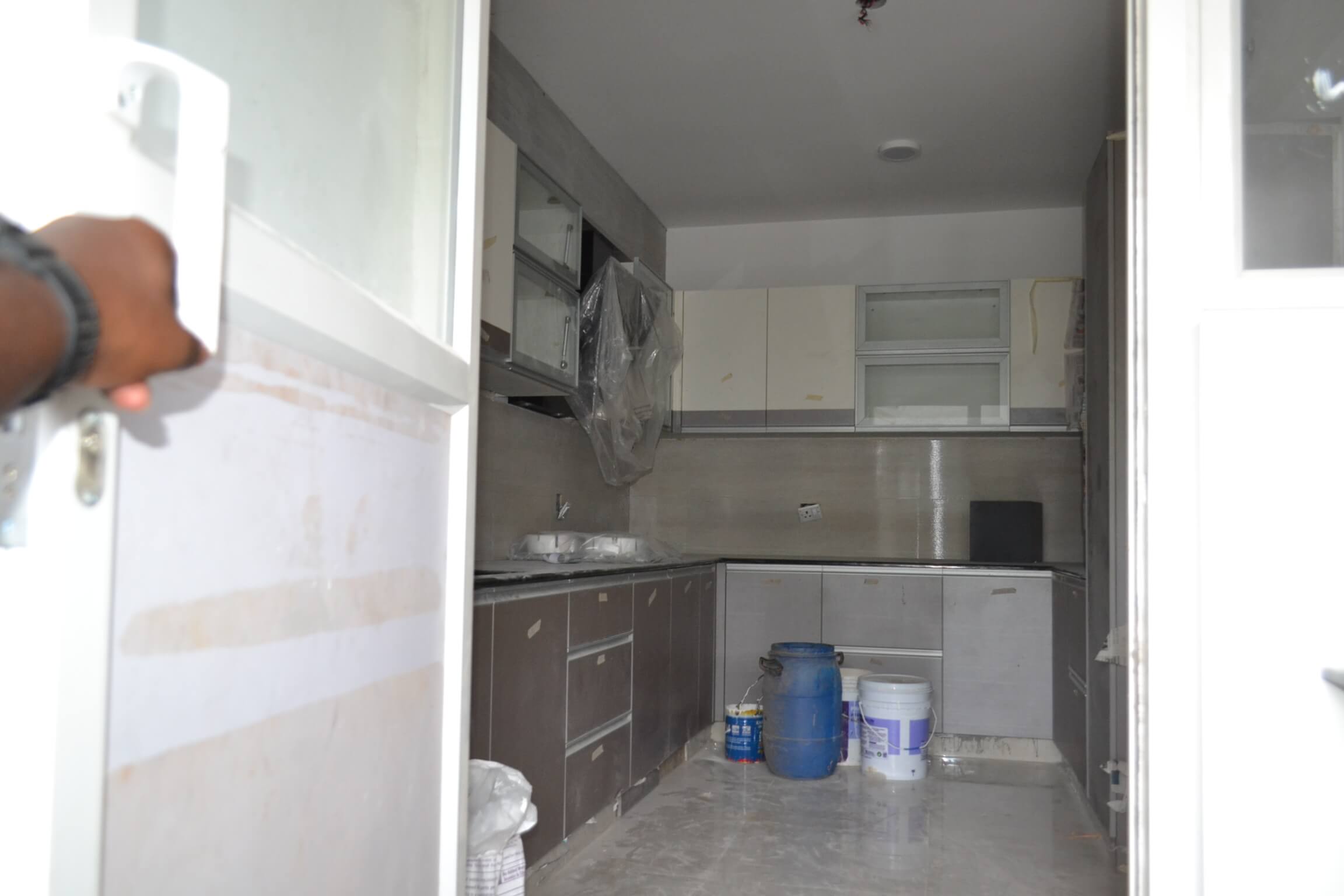

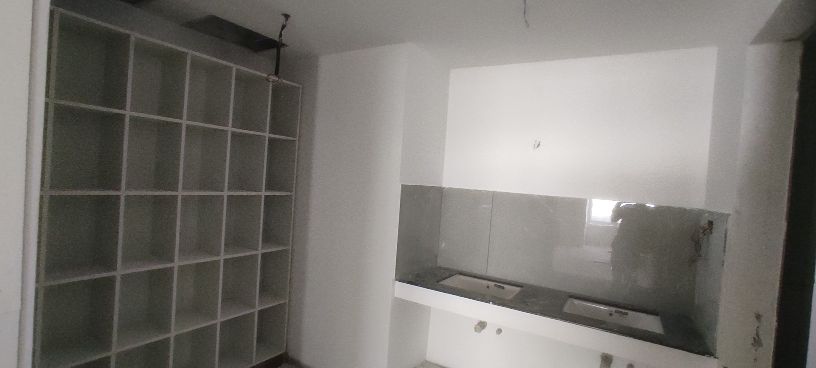

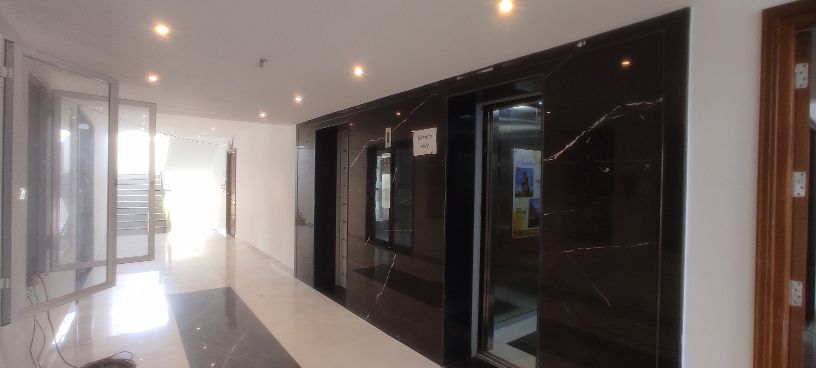

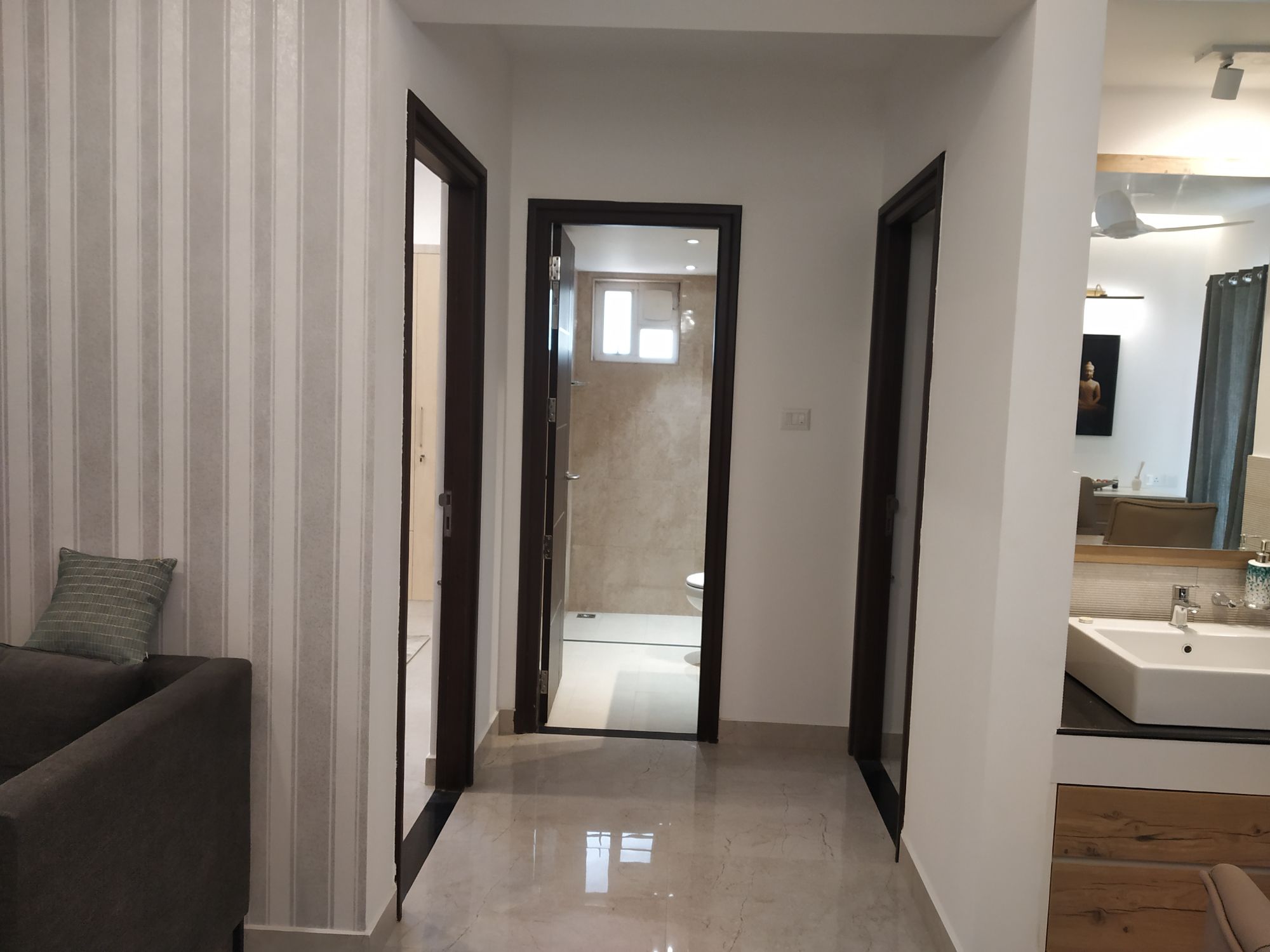

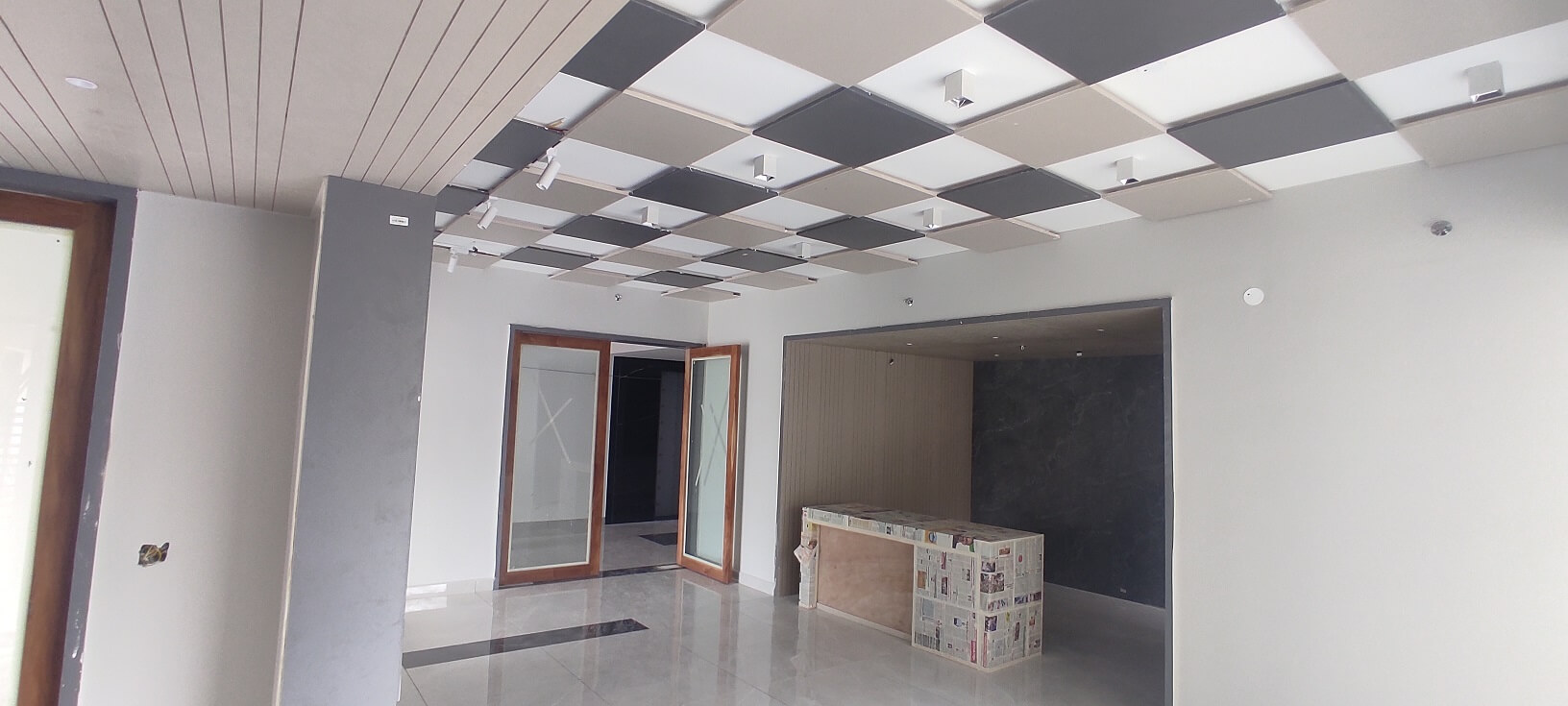

- Internal Finishes – Main door – completed, Waterproofing- completed, Wall tiling – BF -1, G/F to 17th floor completed, BF -2, completed, Flooring – BF – 1 completed, G/F to 17th floor completed (99% completed), BF – 2, completed, BF – 3, 95% completed, Terrace completed, putty works & Painting- 1st Floor to 17th Floor Flat inside 1st and 2nd coat putty and one coat primer completed, BF-3 to Terrace 2 coat putty and primer completed, BF -3 Floor to 17th Floor stair and passage 2nd coat putty and one coat primer completed, Door frame fixtures- BF 2 to 4th Floor completed, Handrails- completed

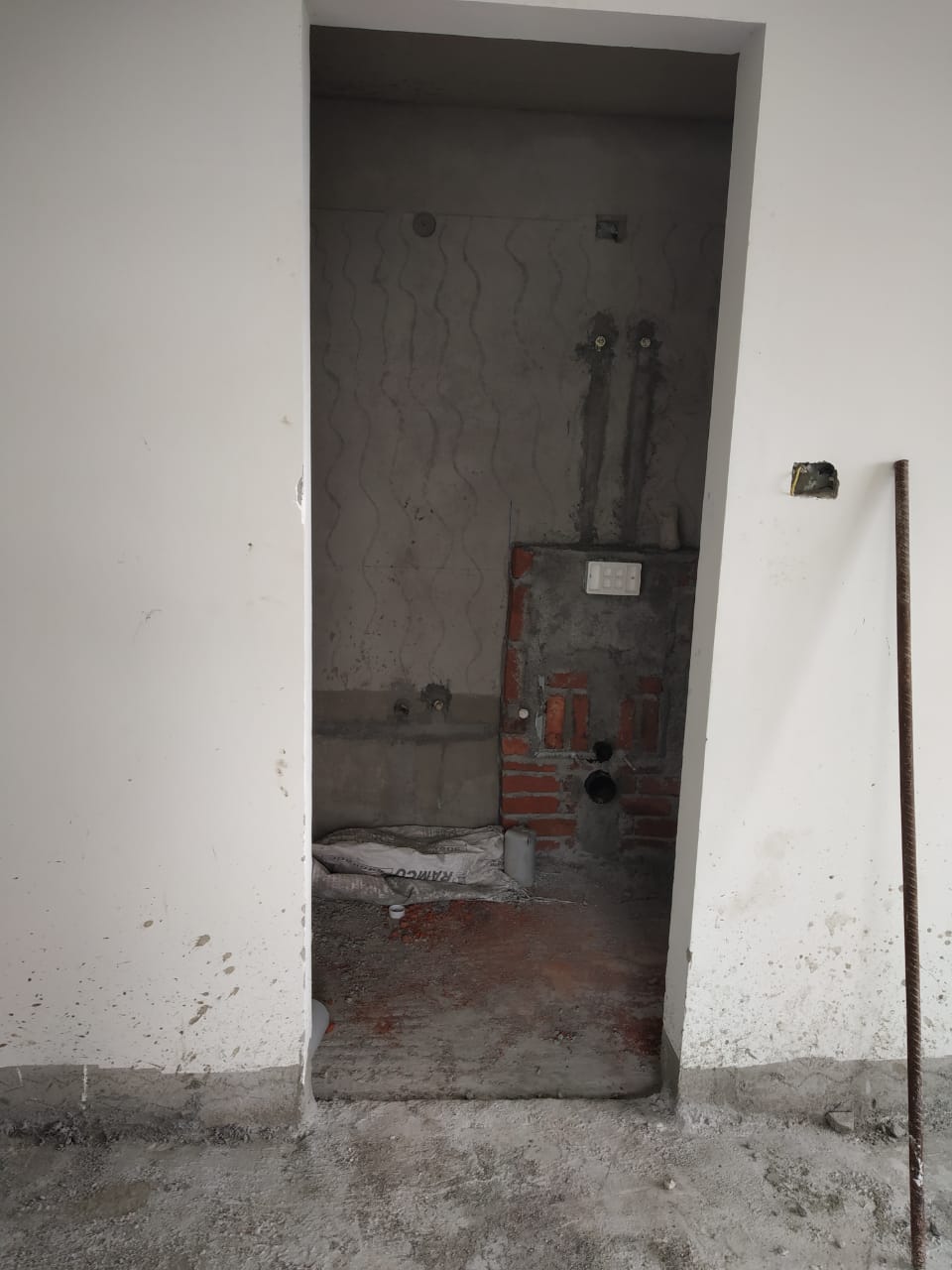

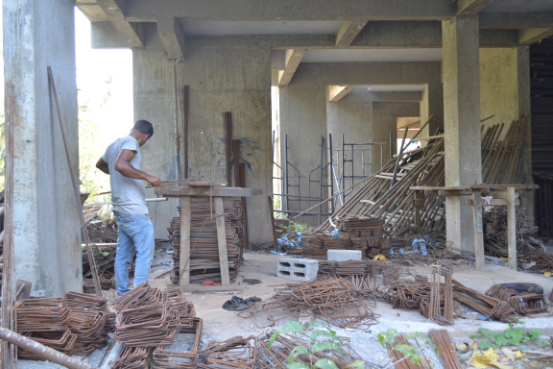

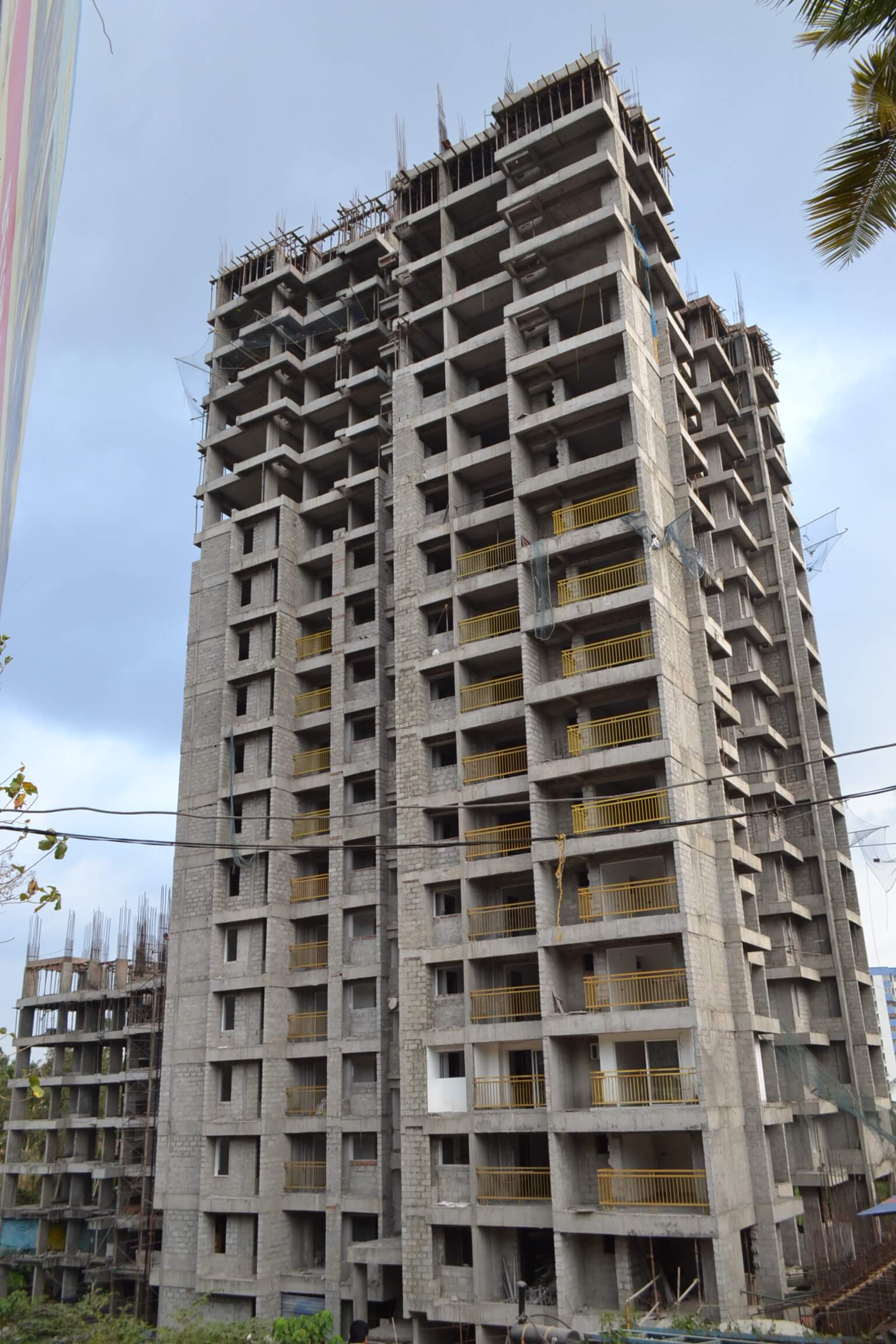

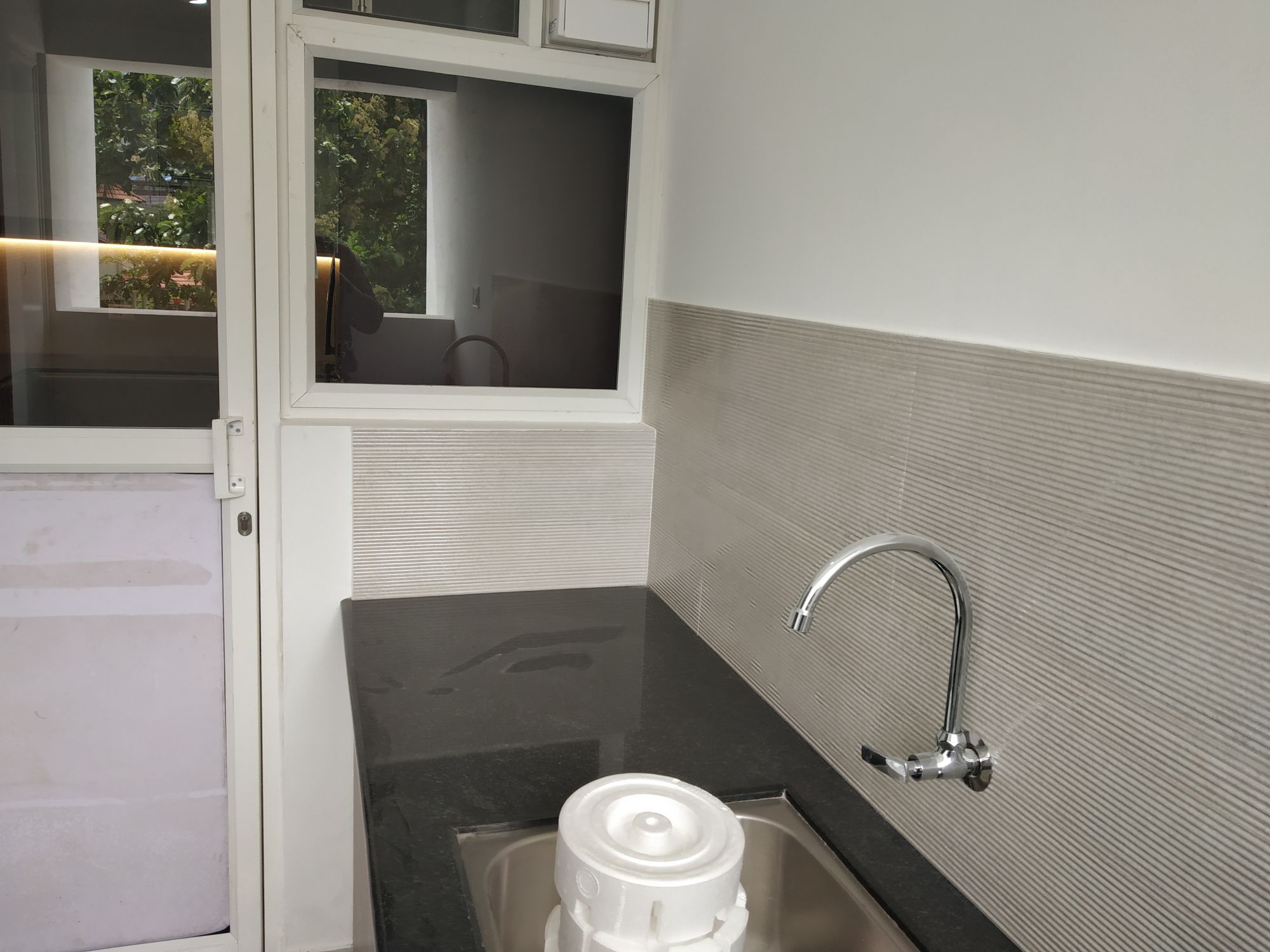

- Electrical, Plumbing & Firefighting works – Concealed plumbing works – G/F to Terrace completed, BF – 1 Completed, BF -2 Completed, Corridor handrail works – completed, Wall and floor services, Risers, – completed, Centralised Gas piping system – 90% completed (GF to 17th floor)

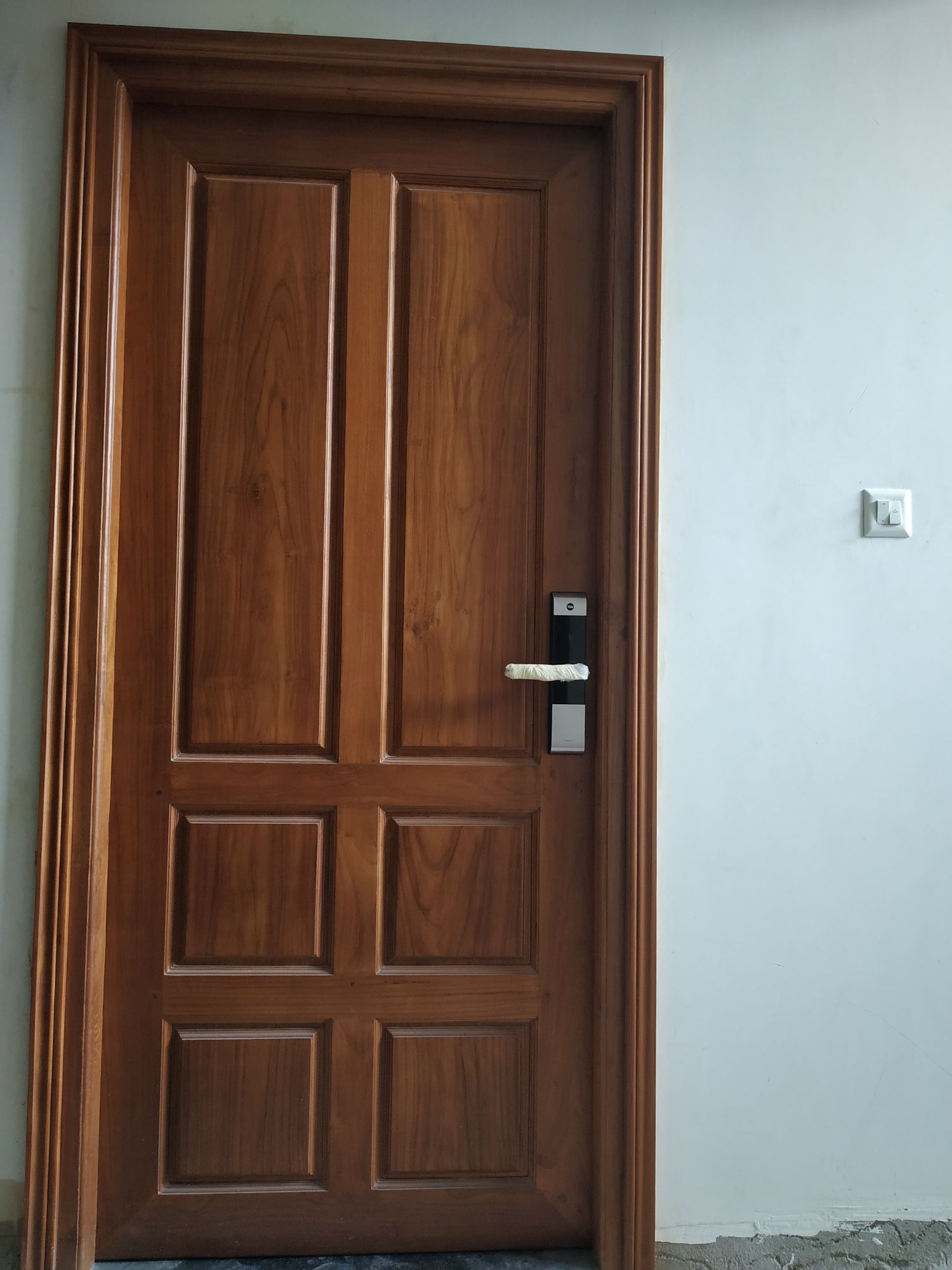

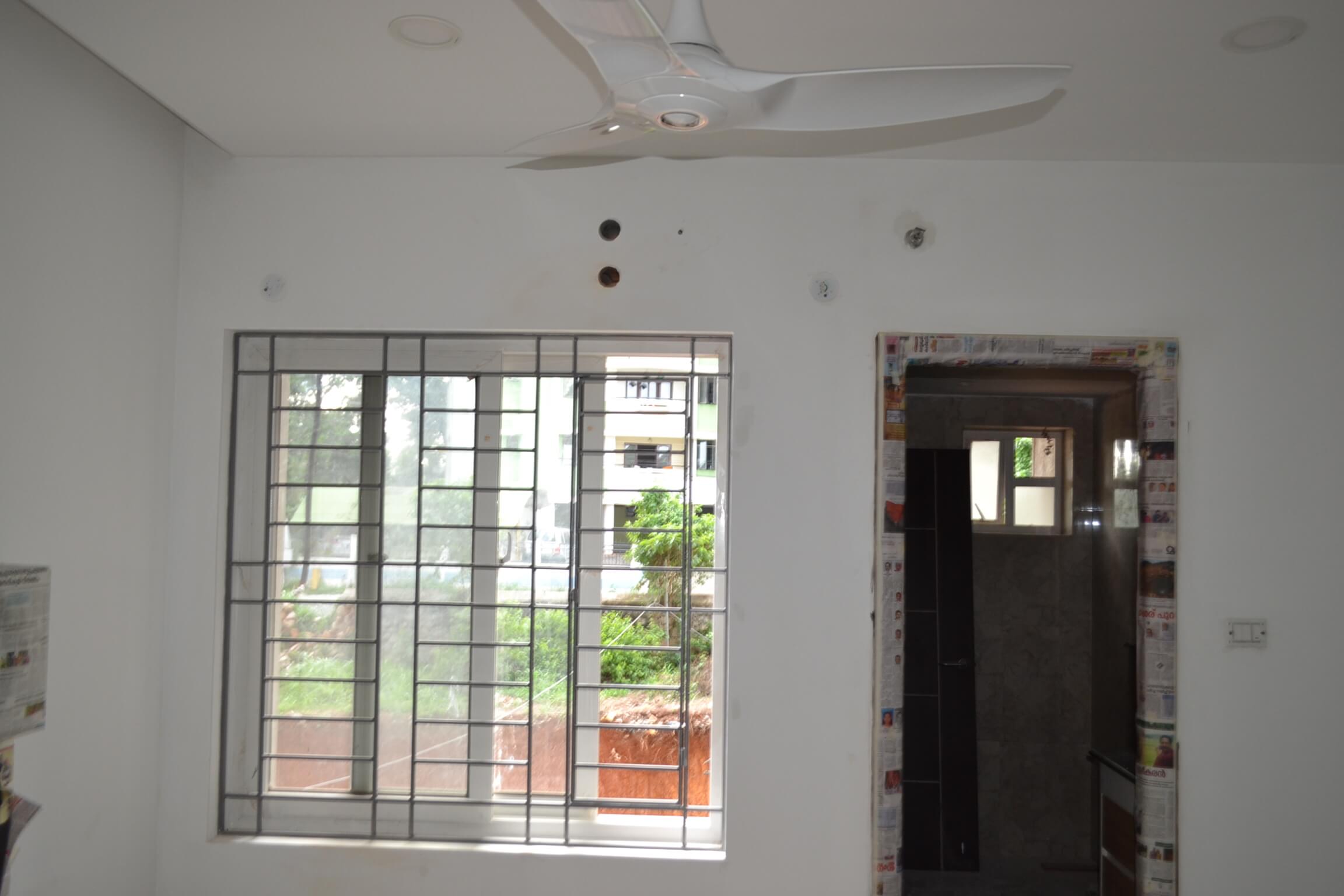

- Final Finishes – Door shutters & ironmongery, – 71 flats completed, Final Painting – Two coat painting 60 flats completed, Plumbing & Sanitaryware – 52 flats completed, Electrical final fixtures – 62 flats completed, Firefighting final fixtures – 62 flats completed

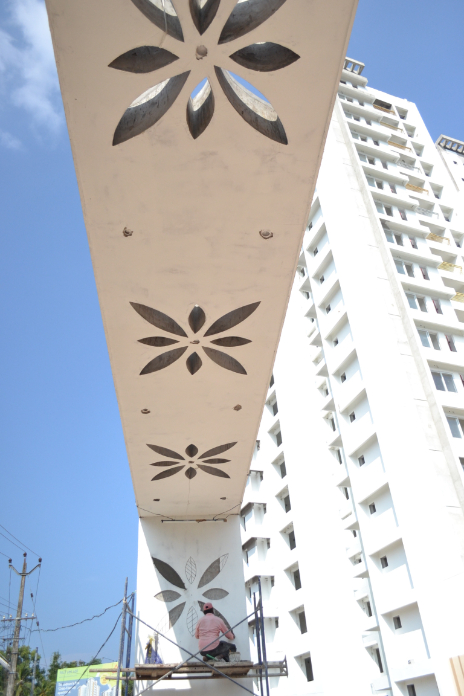

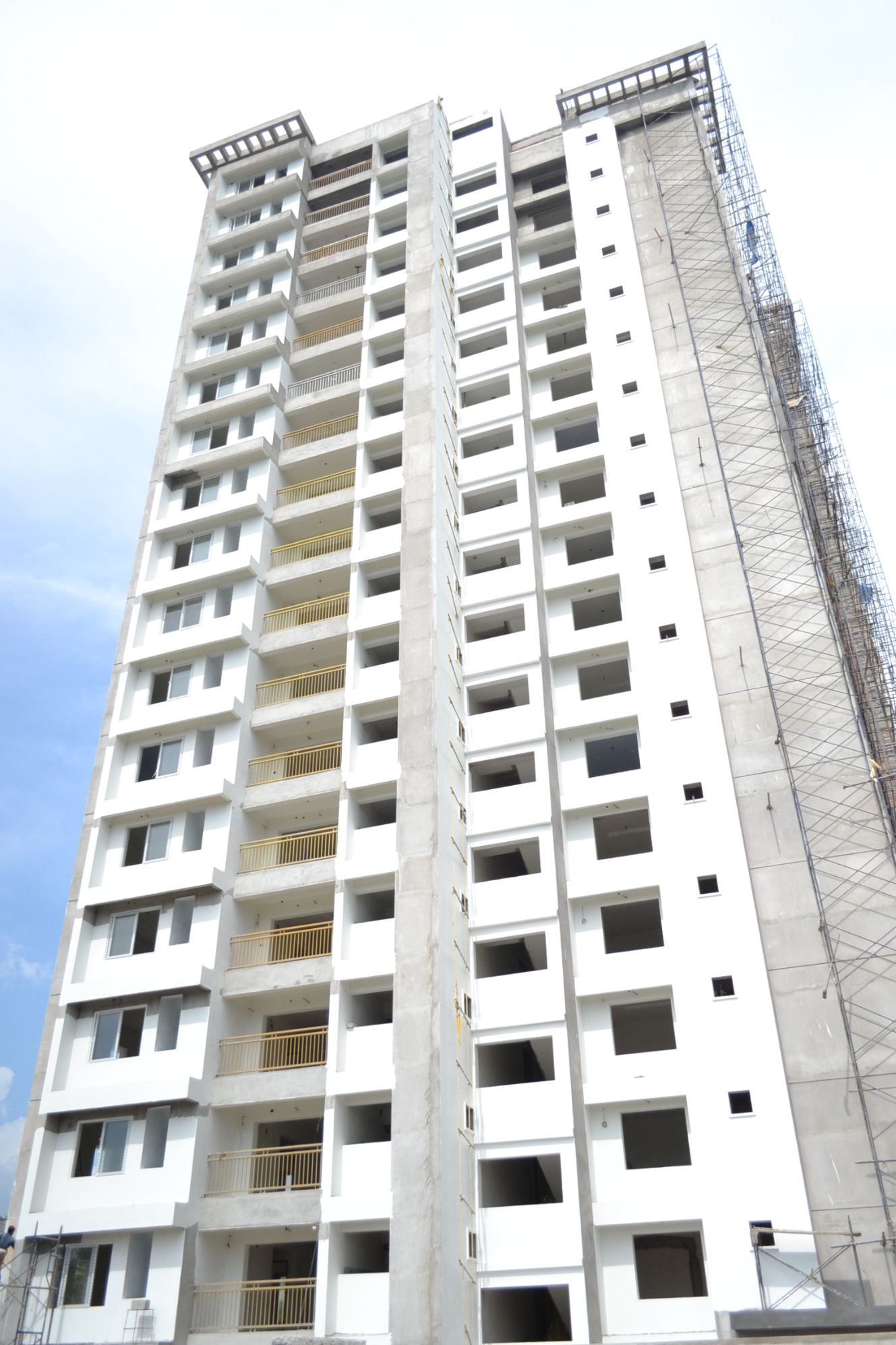

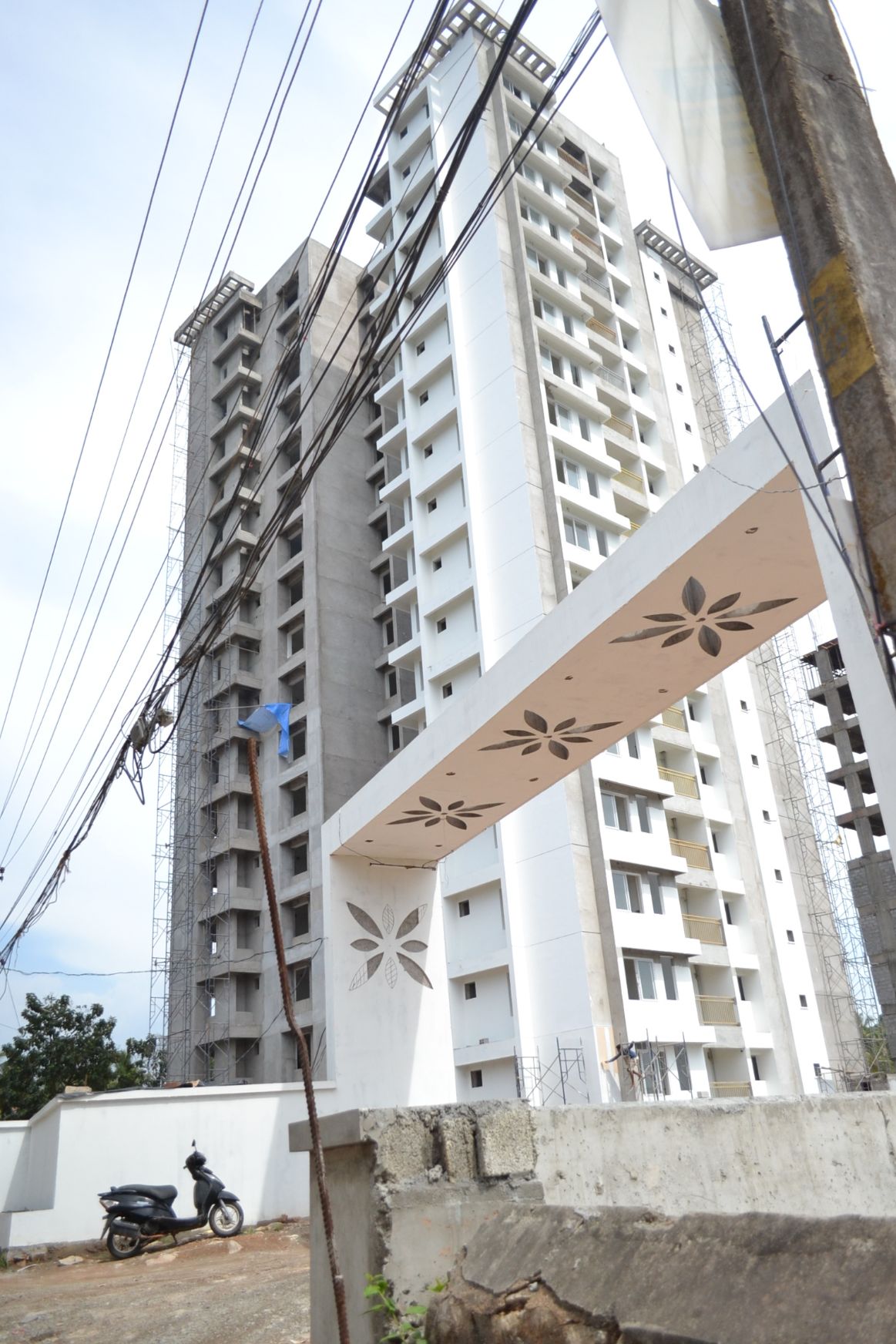

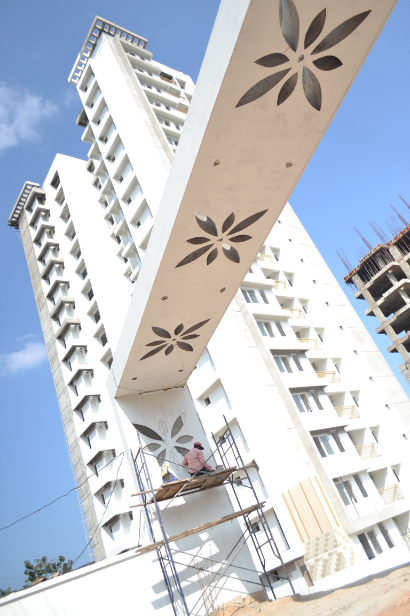

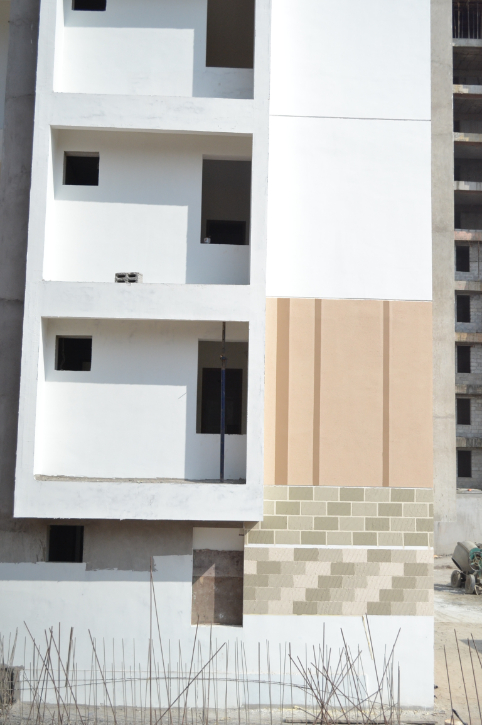

- External Finishes – Windows & Sliding doors – 90% completed, External Plastering- completed, External Painting – 1st coat painting completed, 2nd coat painting – 75% completed

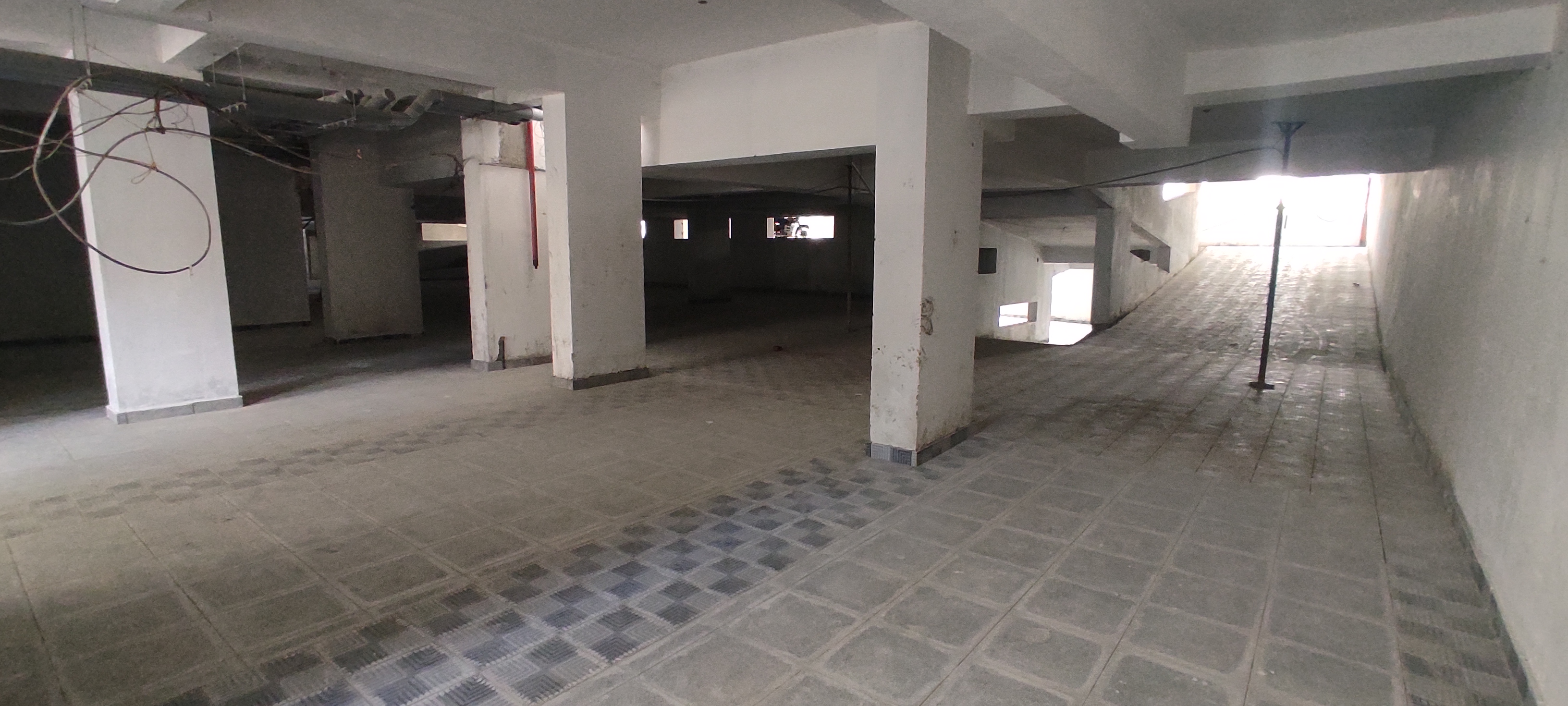

- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – completed, Reticulated gas piping – 100% completed, Painting – 100% completed

ARTECH METROPOLIS (TOWER-2)

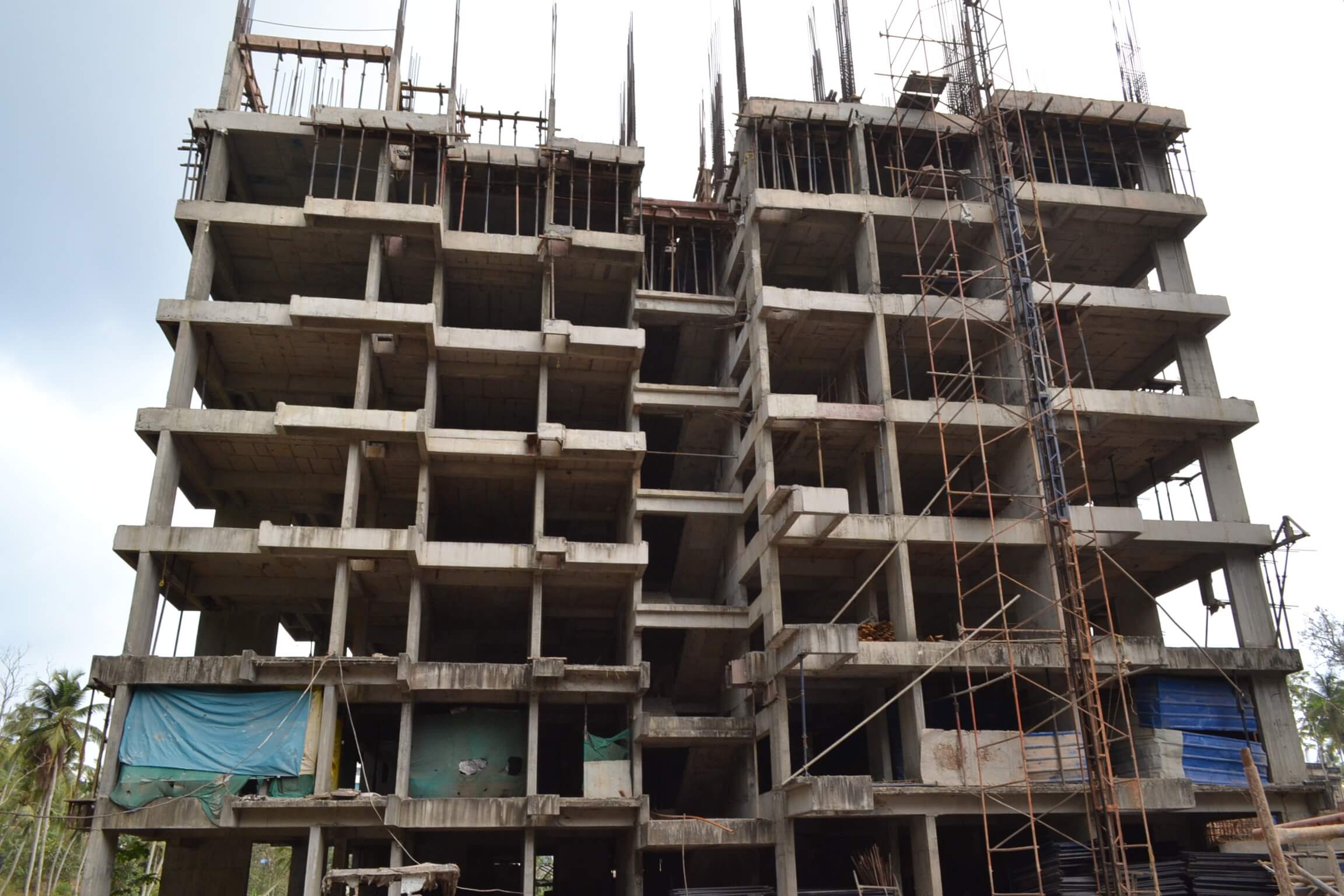

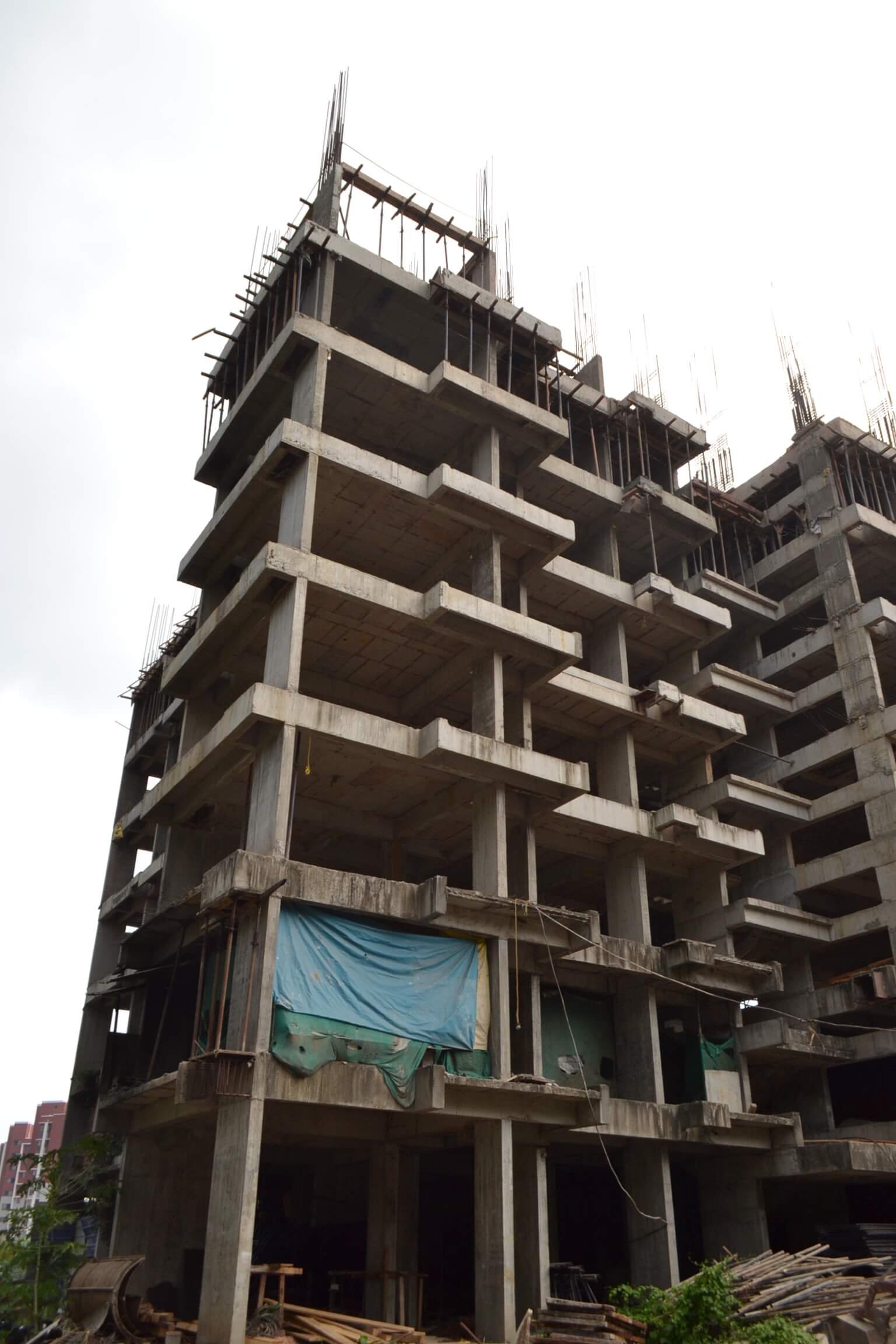

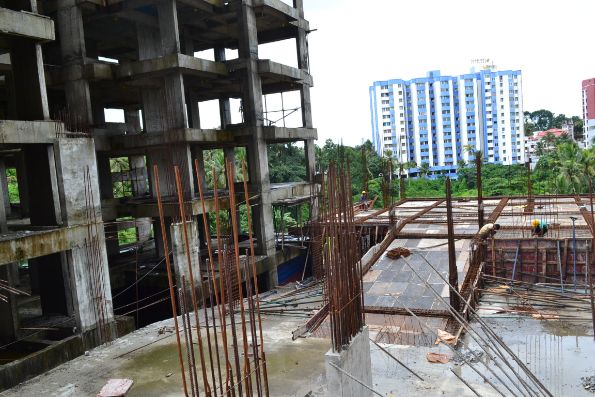

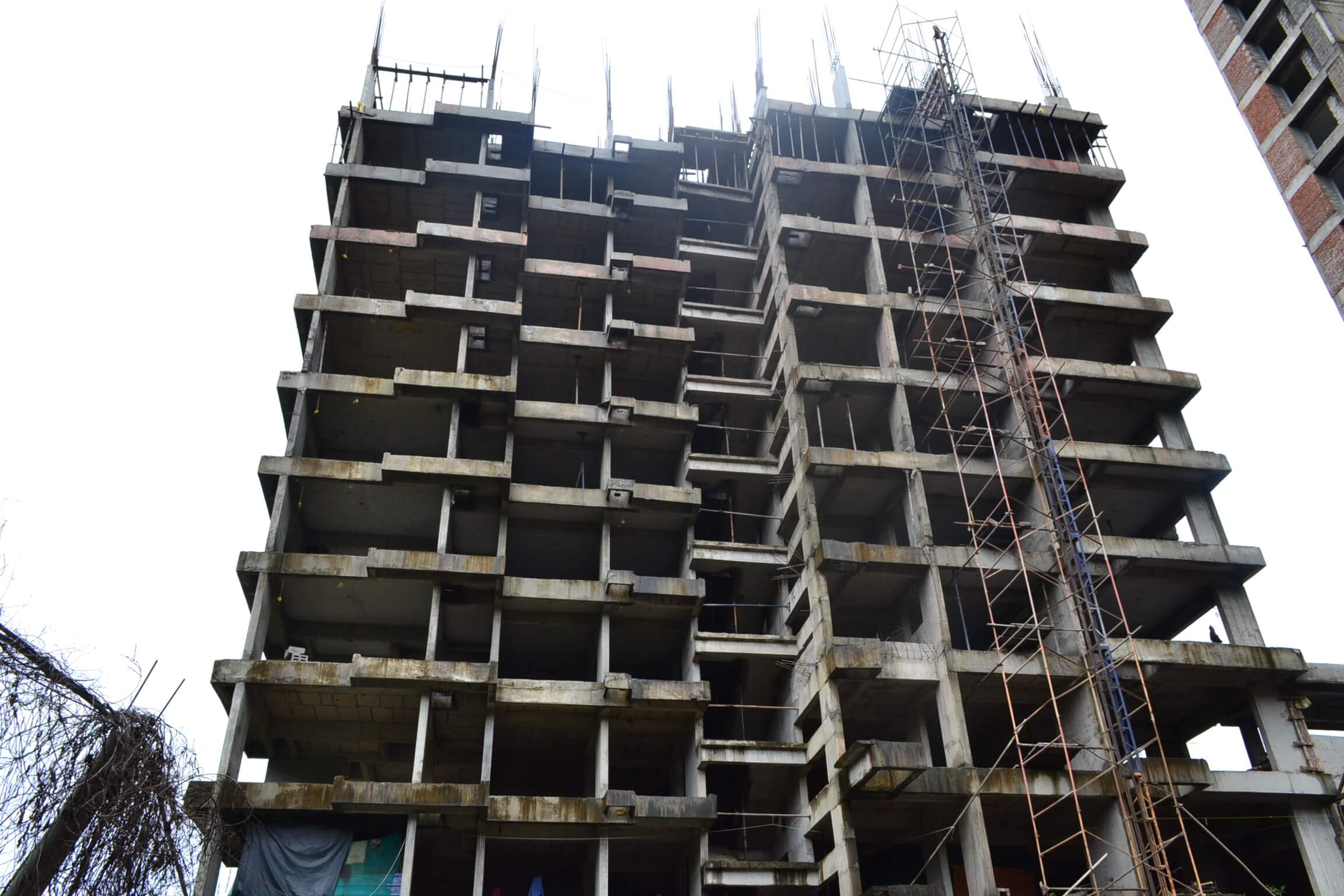

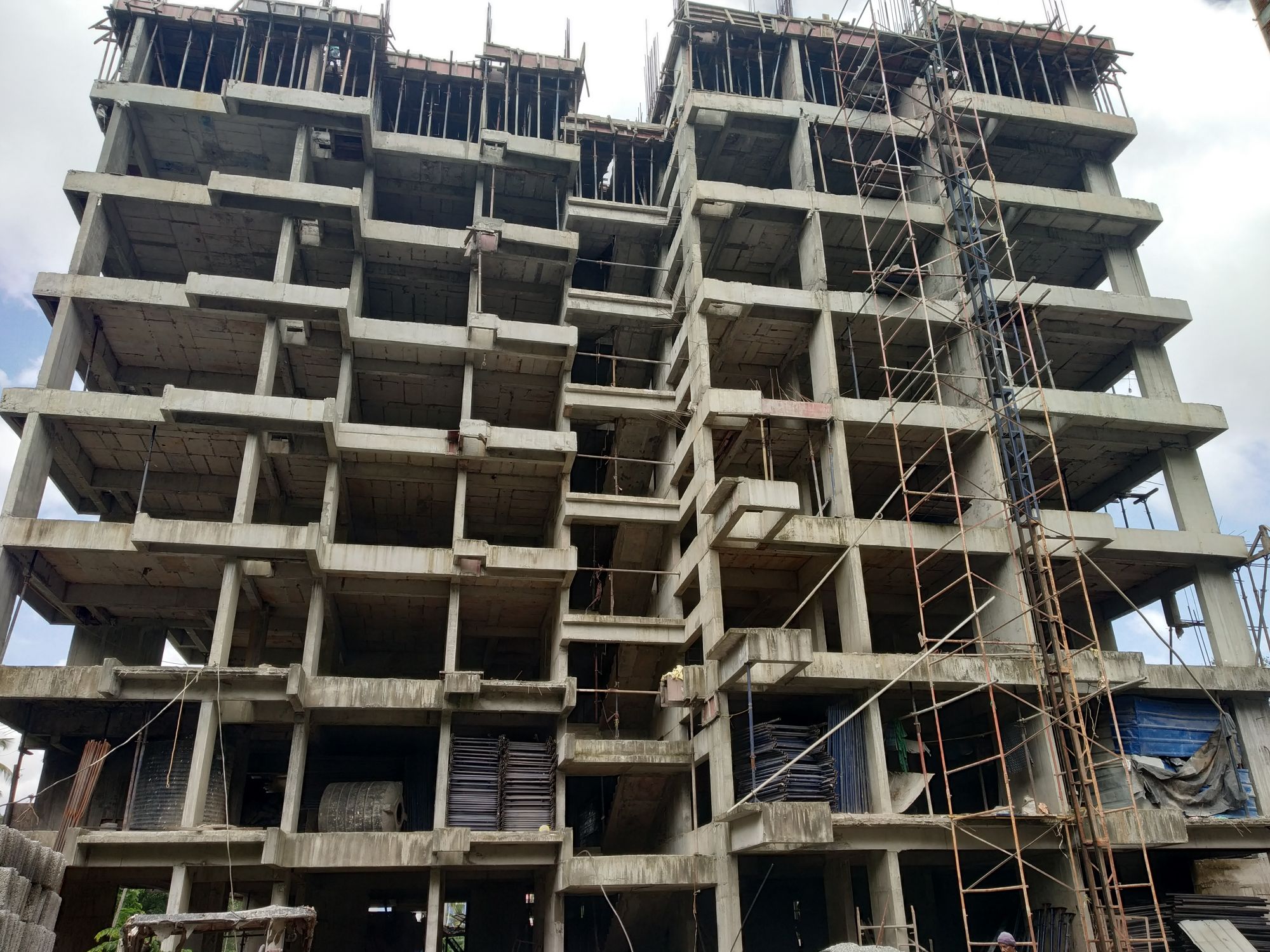

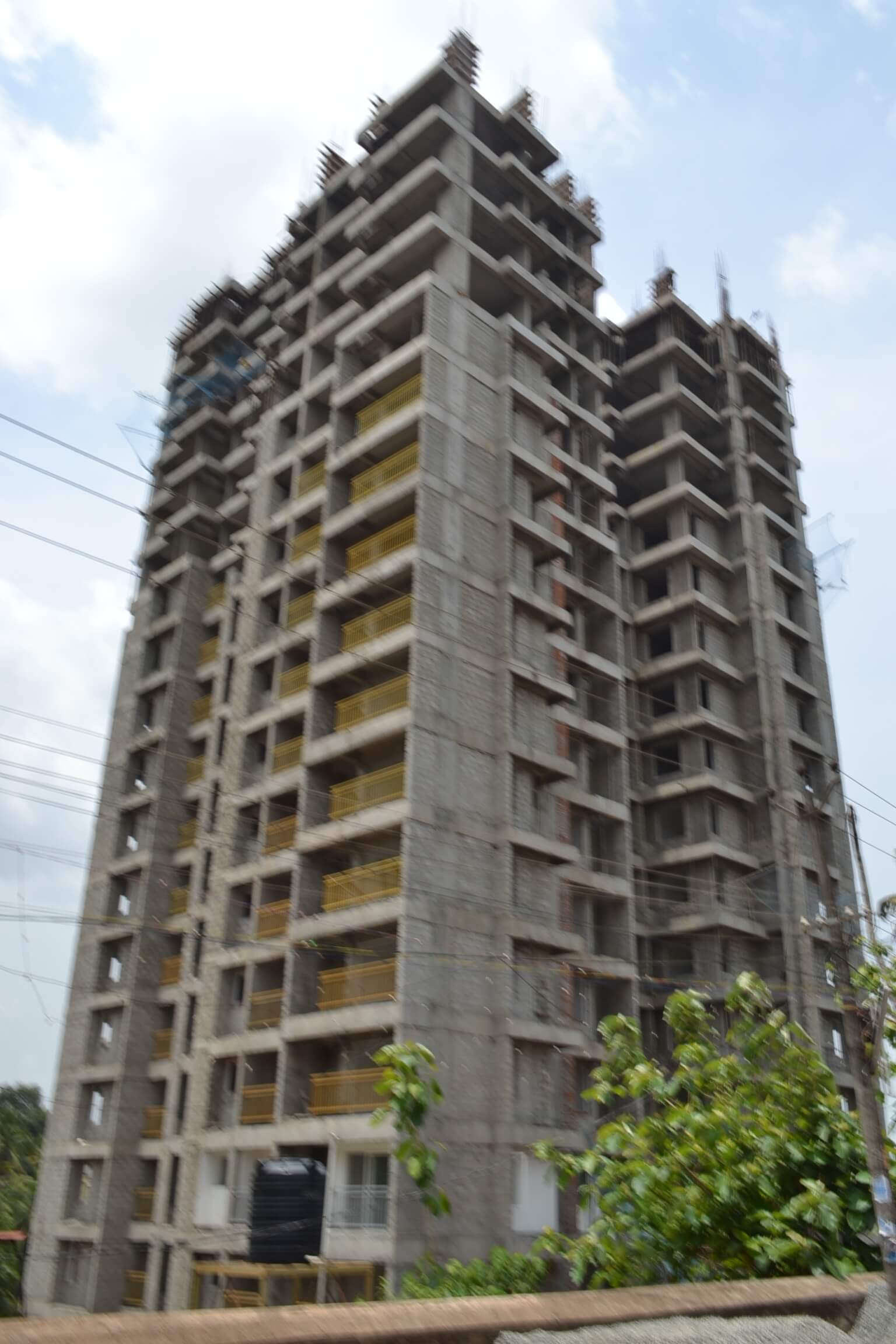

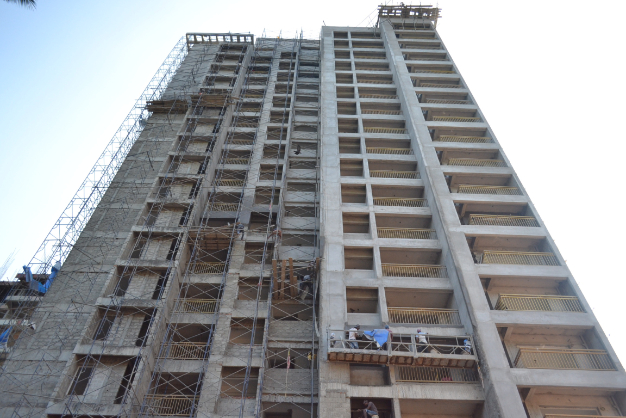

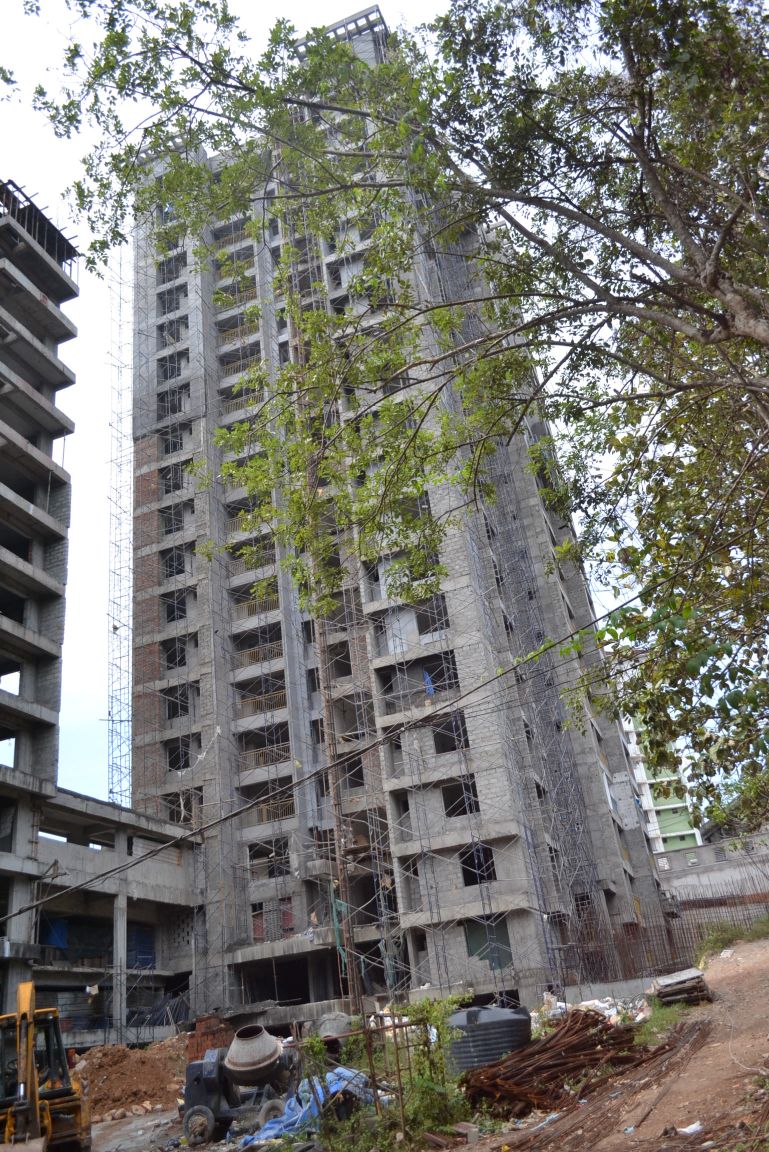

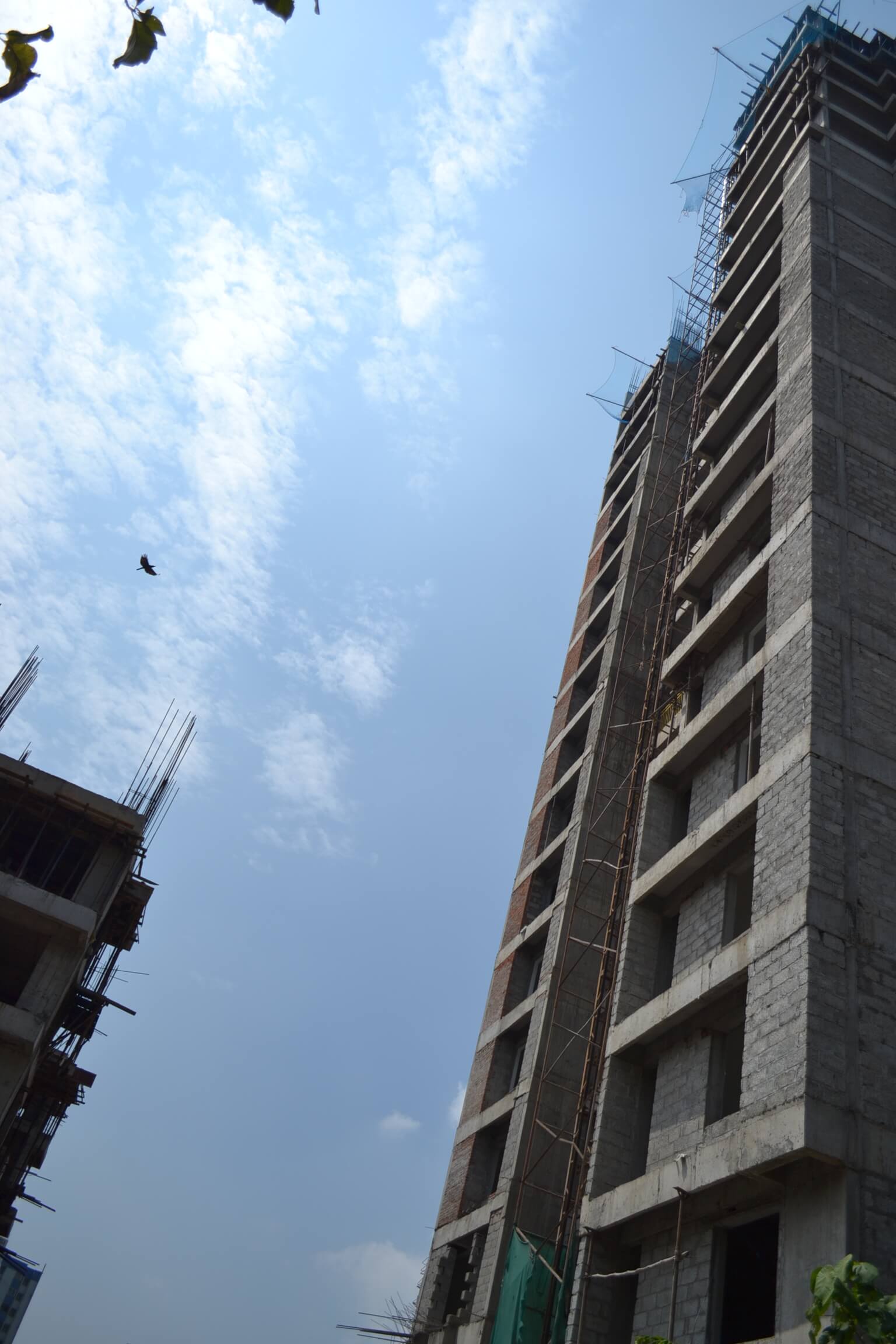

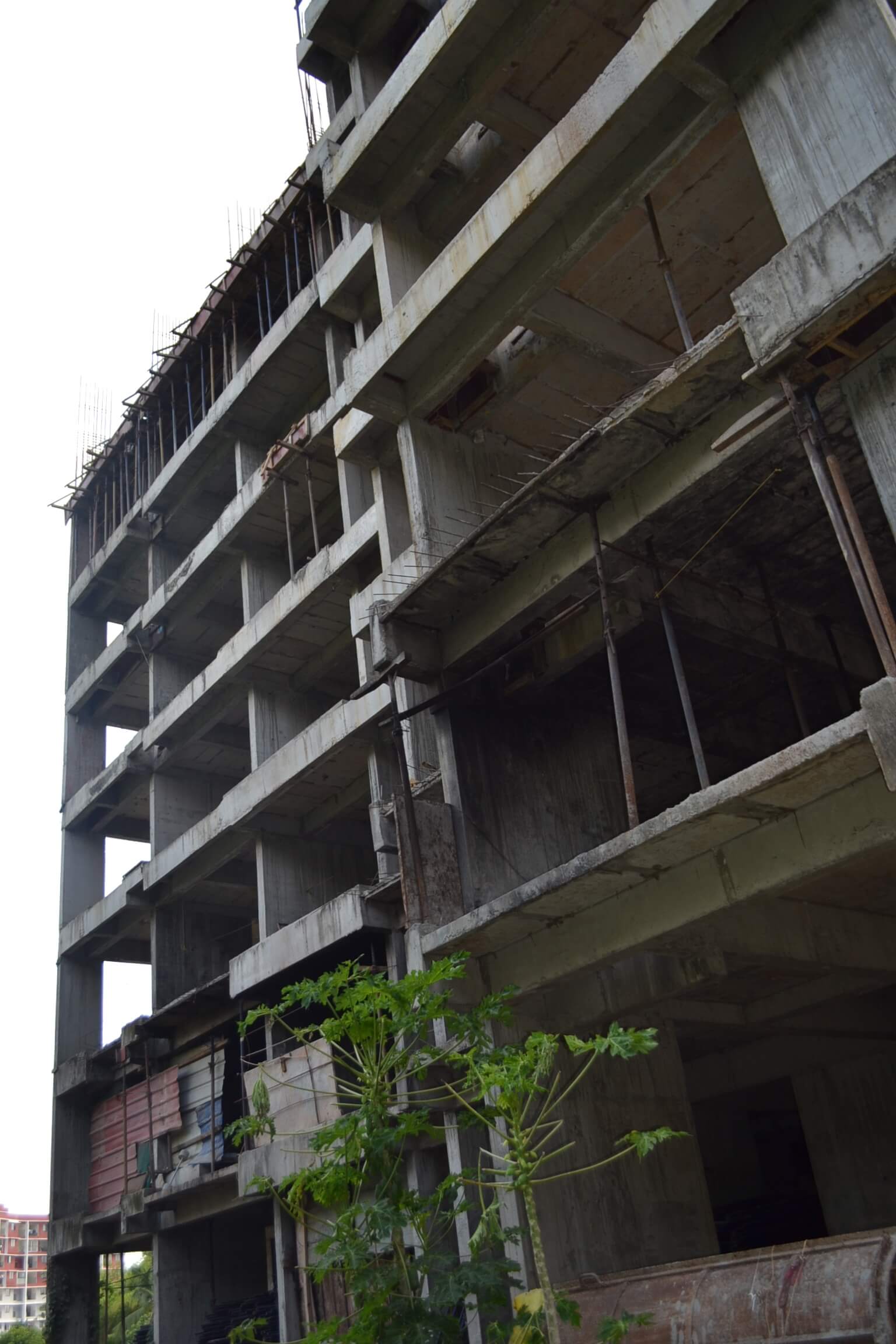

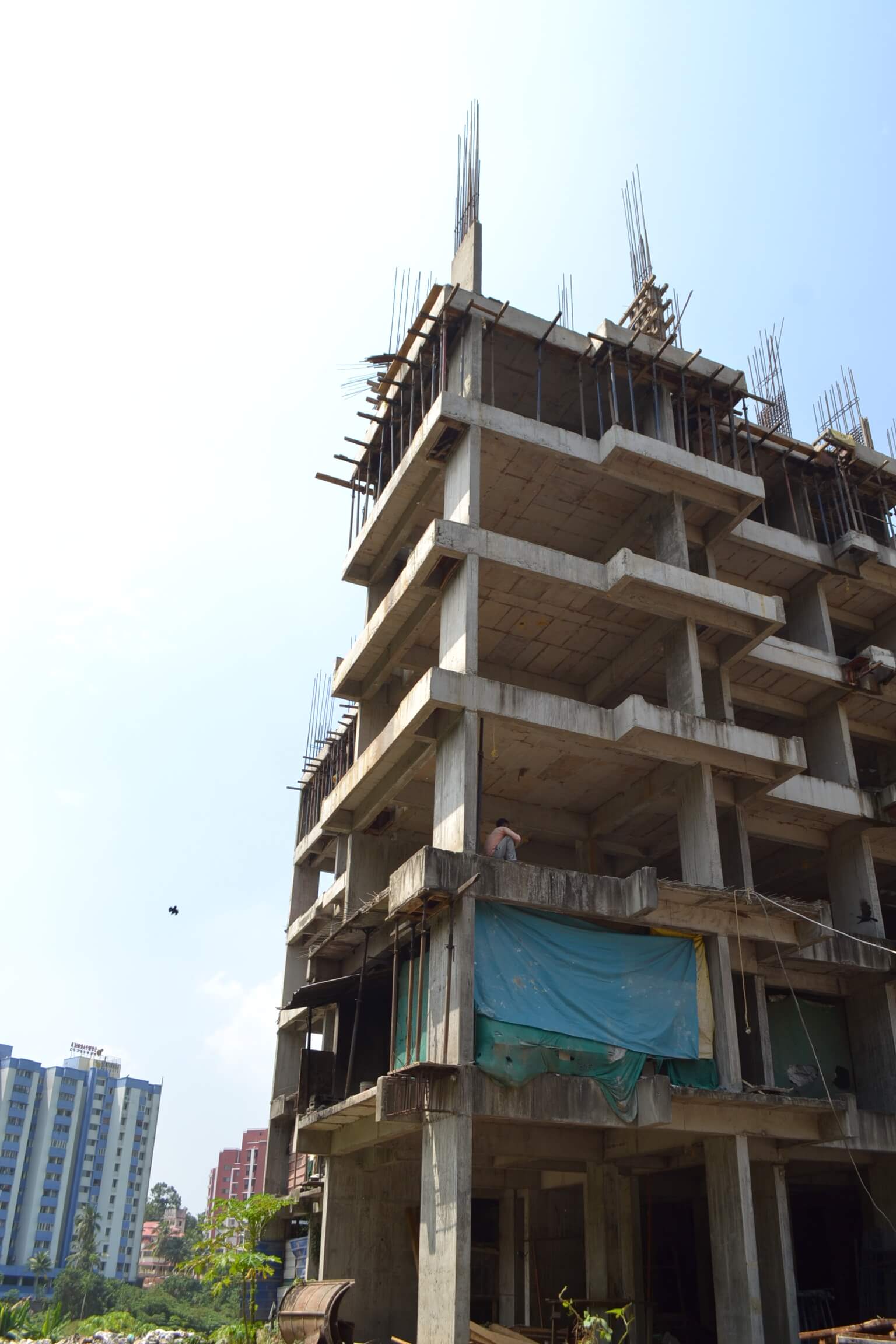

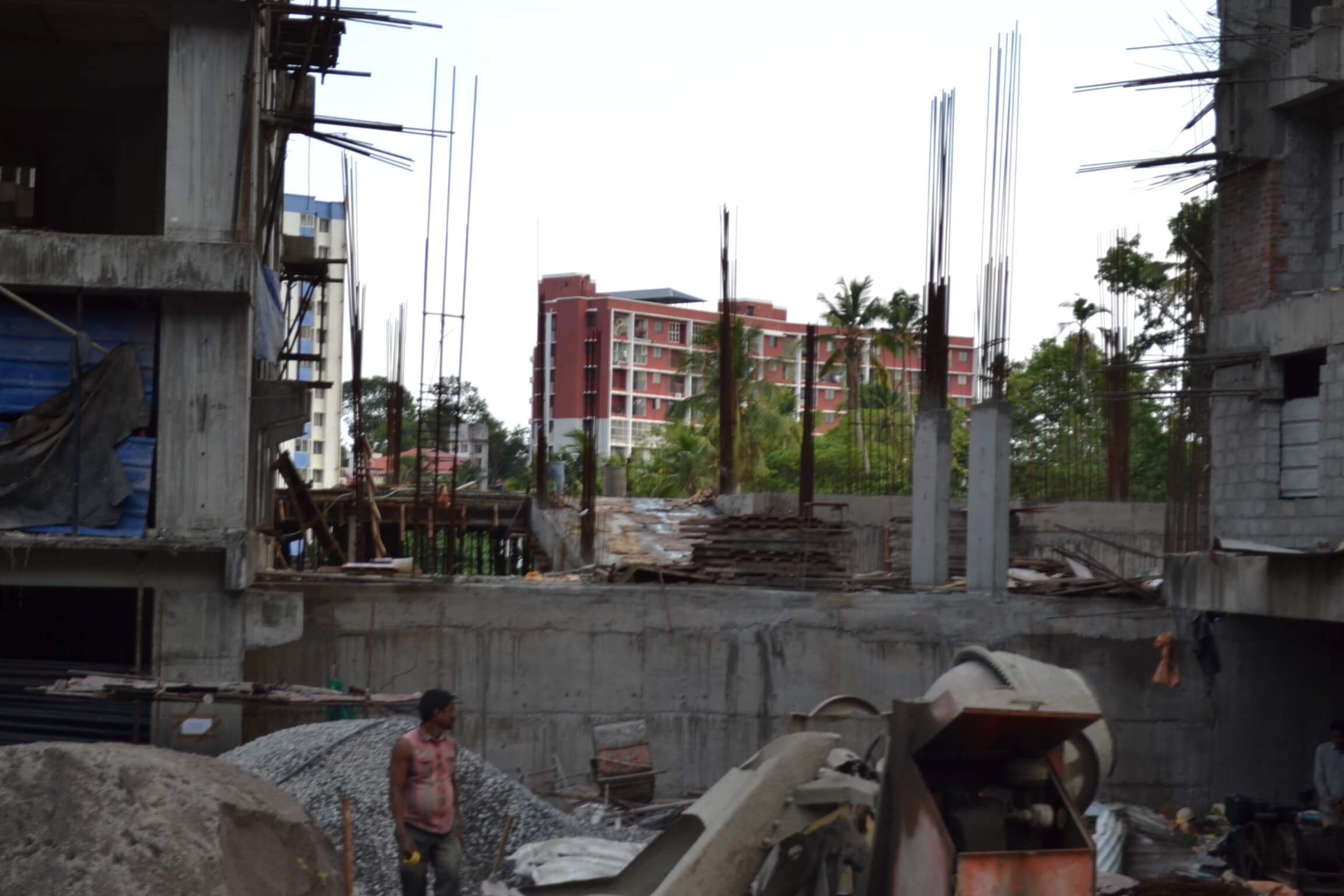

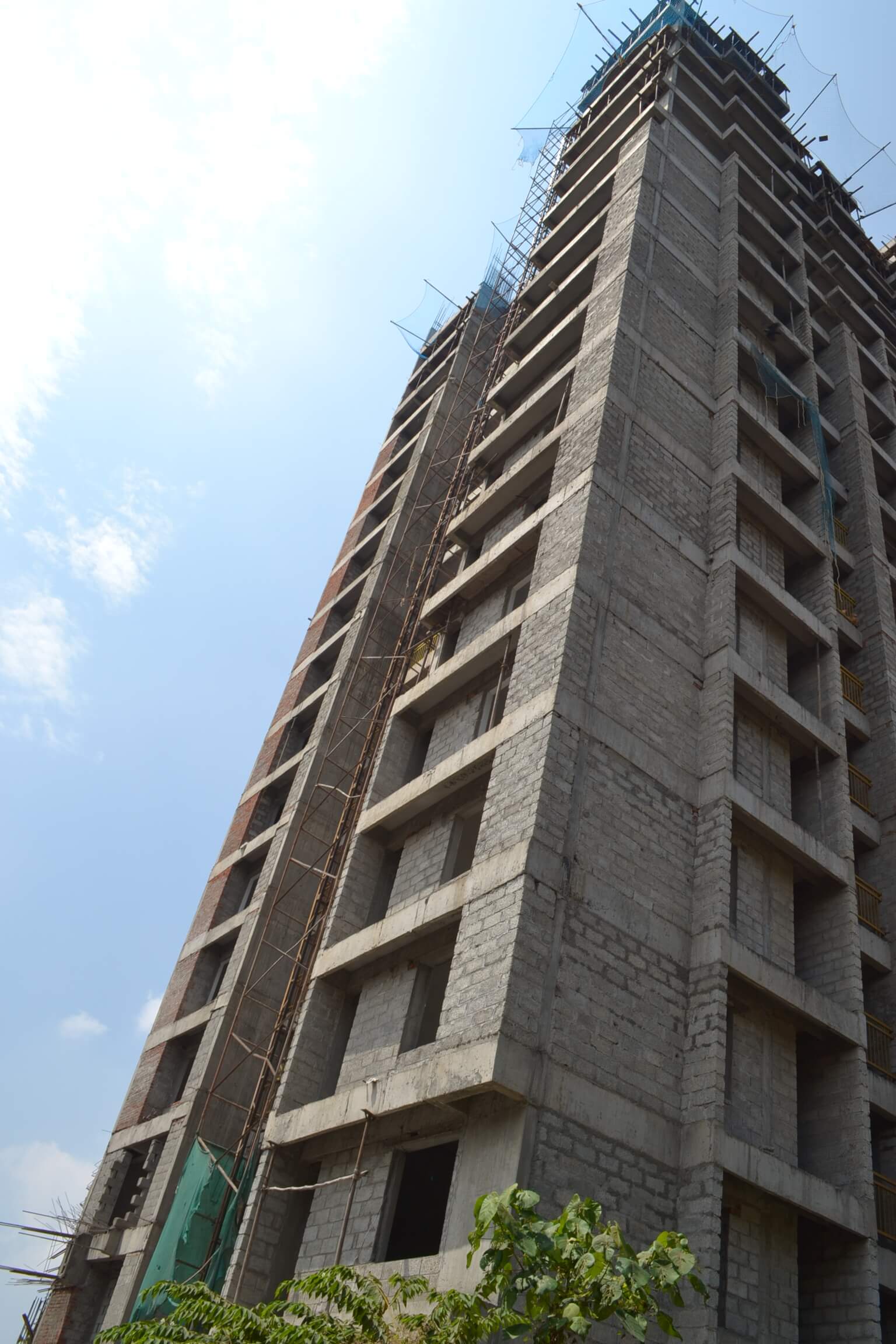

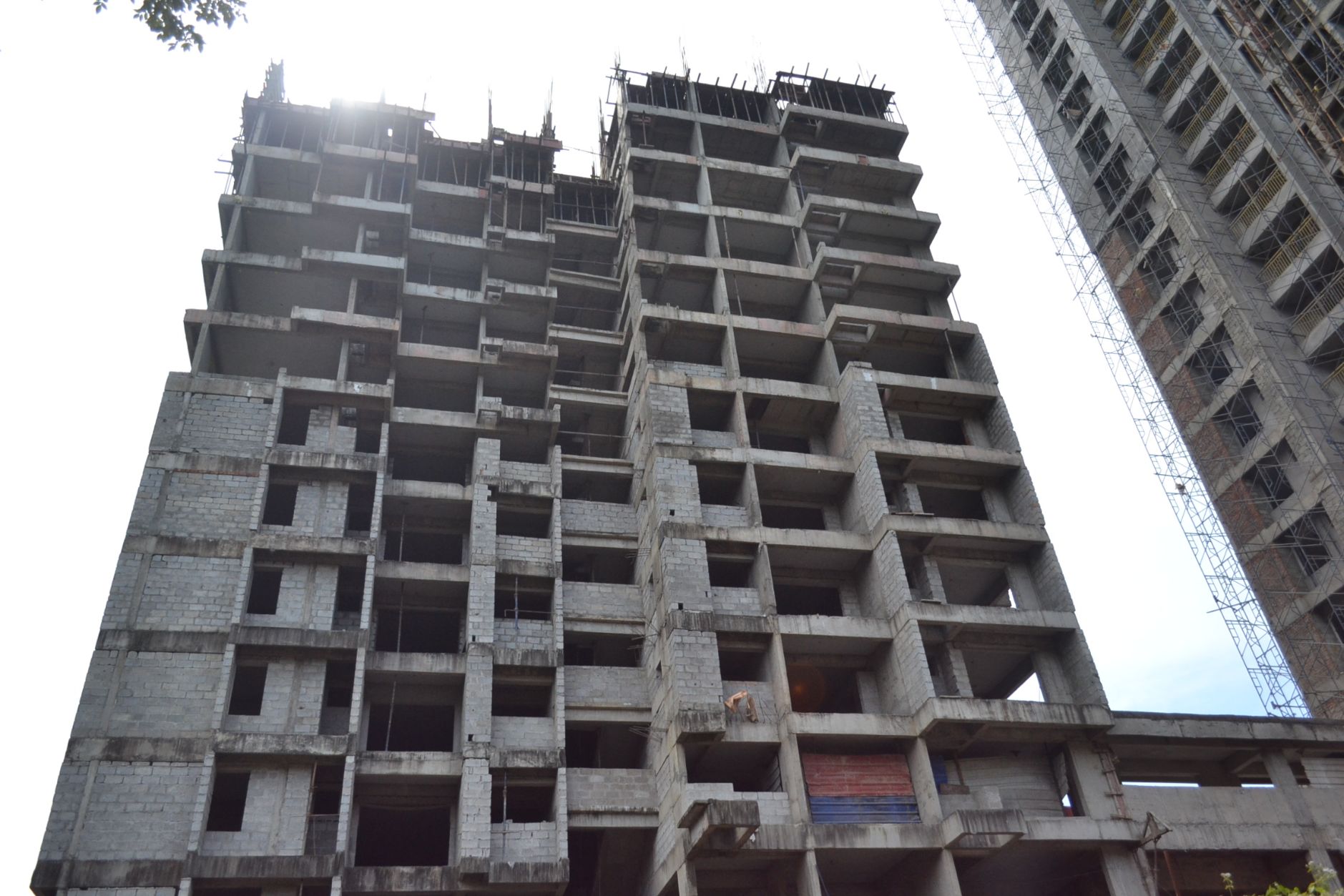

- Structural Works – Pile cap – completed , slab completed – upto terrace Floor completed, All pergola completed, terrace Parapet completed, Lift machine room base and cover slab completed, stair case head room completed, OH tank base, wall and cover slab completed

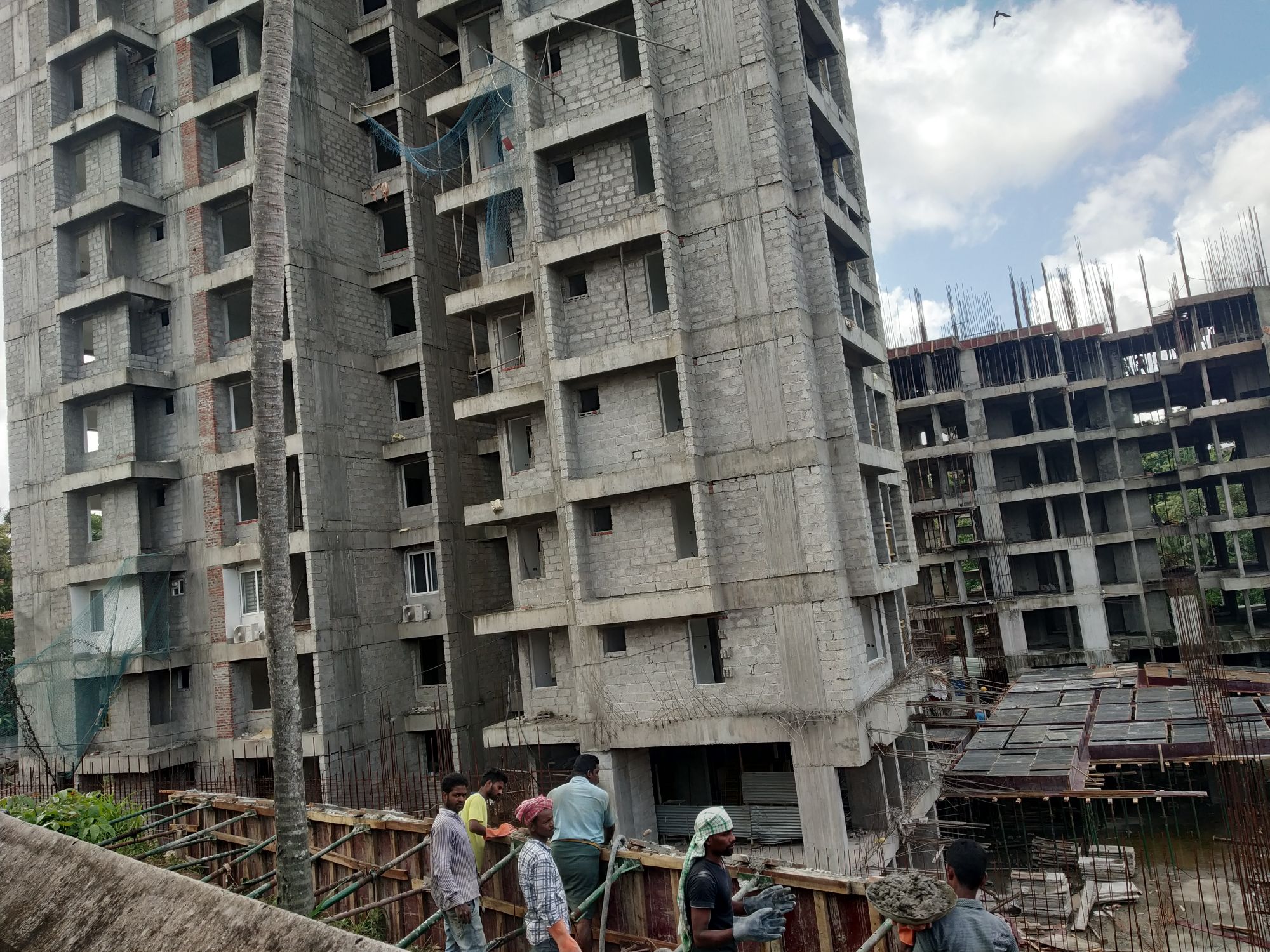

- Civil Works – Ceiling plaster completed, wall plastering upto 16th floor completed, machine room plastering – completed, Masonry – Block/ brick completed, BF – 16th floor completed.
- Internal Finishes – Waterproofing – 1st to 16th floor completed, Flooring – sample flat completed, 1st floor – 70% completed, 2nd floor – 70% completed, 5th floor – 70% completed, 6th floor – 40% completed, wall tiling – 1st floor – 80% completed, 2nd floor – 75% completed, 3rd floor – 25% completed, 5th floor – 50% completed, putty works & Painting- 1st to 13th floor 2 coat putty and 2 coat primer completed, 13th to 16th floor 1st coat primer completed, Door frame fixtures – Main door frame – BF – 3 to 16th floor completed, Handrails – 1st to 16th floor completed, Fire stair – BF -1 to terrace completed, Mainstair – 50% completed.
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – sunken filling up to 13th floor completed, flush tank fixing 1st to 9th floor completed

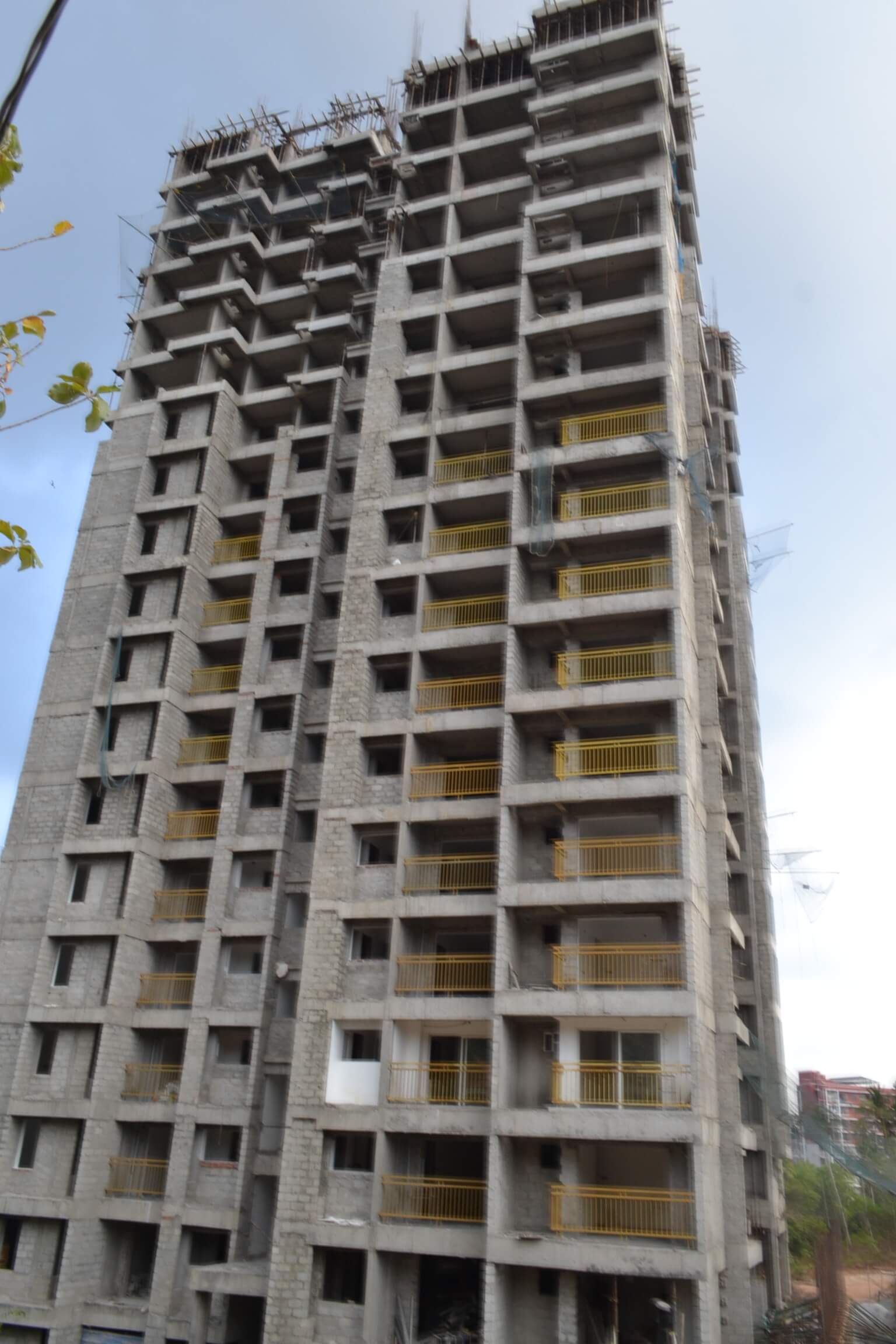

- External Finishes – Windows and sliding doors -70% completed, External Plastering : west side completed, South side – completed, North side – completed, East side – completed, External painting – west side painting completed, North side painting completed, east side – completed
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – completed, Reticulated gas piping – 100% completed, Painting – Primer application completed
As per the current work status from our site, we are targeted to complete the following works by the end of MARCH 2023.
ARTECH METROPOLIS ( TOWER -1 )
- Internal Finishes – Flooring – BF – 3, 100% to be completed
- Electrical, Plumbing & Firefighting works – gas work 100% to be completed.
- Final Finishes – Door shutter fixing – 5 more flats to be completed, painting- two coat painting – 10 more flats to be completed, plumbing & sanitary – 5 more flats to be completed, Eletrical final fittings – 10 more flats to be completed, Fire fighting final fitting – 14 more flats to be completed
- External Finishes – Windows and sliding doors – 100% to be completed, External painting – 2nd coat painting 100% to be completed.
ARTECH METROPOLIS (TOWER-2)
- Internal Finishes – Flooring – 1st floor 30% more to be completed, 5th Floor – 30% more to be completed and 6th floor – 75% to be completed, Wall Tile work – 5th floor 100% to be completed, putty works and painting – 14th floor 2 coat putty and 2 coat primer 100% to be completed, Handrail – Mainstair handrail – 40% more to be completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing works -14th to 16th floor to be completed
- External Finishes – Windows and sliding doors -30% more to be completed
Work status as on 11-02-2023, we have completed the following.
ARTECH METROPOLIS ( TOWER -1 )
- Structural Works – All sub-structural and structural works- completed
- Civil Works – Completed
- Internal Finishes – Main door – completed, Waterproofing- completed, Wall tiling – BF -1, G/F to 17th floor completed, BF -2, completed, Flooring – BF – 1 completed, G/F to 17th floor completed (99% completed), BF – 2, completed, BF – 3, 90% completed, Terrace completed, putty works & Painting- 1st Floor to 17th Floor Flat inside 1st and 2nd coat putty and one coat primer completed, BF-3 to Terrace 2 coat putty and primer completed, BF -3 Floor to 17th Floor stair and passage 2nd coat putty and one coat primer completed, Terrace 1st coat painting completed, GF to terrace floor passage 1st coat painting completed, Door frame fixtures- BF 2 to 4th Floor completed, Handrails- completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – G/F to Terrace completed, BF – 1 Completed, BF -2 Completed, Corridor handrail works – completed, Wall and floor services, Risers, – completed, Centralised Gas piping system – 90% completed (GF to 17th floor)
- Final Finishes – Door shutters & ironmongery, – 71 flats completed, Final Painting – Two coat painting 50 flats completed, Plumbing & Sanitaryware – 48 flats completed, Electrical final fixtures – 55 flats completed, Firefighting final fixtures – 52 flats completed
- External Finishes – Windows & Sliding doors – 90% completed, External Plastering- completed, External Painting – 1st coat painting completed, 2nd coat painting – 25% completed
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – completed, Reticulated gas piping – 100% completed, Painting – 100% completed
ARTECH METROPOLIS (TOWER-2)
- Structural Works – Pile cap – completed , slab completed – upto terrace Floor completed, All pergola completed, terrace Parapet completed, Lift machine room base and cover slab completed, stair case head room completed, OH tank base, wall and cover slab completed
- Civil Works – Ceiling plaster completed, wall plastering upto 16th floor completed, machine room plastering – completed, Masonry – Block/ brick completed, BF – 16th floor completed.
- Internal Finishes – Waterproofing – 1st to 16th floor completed, Flooring – sample flat completed, 1st floor – 70% completed, 2nd floor – 70% completed, 5th floor – 70% completed, wall tiling – 1st floor – 80% completed, 2nd floor – 75% completed, 3rd floor – 25% completed, 5th floor – 50% completed, putty works & Painting- 1st to 11th floor 2 coat putty and 2 coat primer completed, 12th floor – 50% completed, 13th to 16th floor 1st coat primer completed, Door frame fixtures – Main door frame – BF – 3 to 16th floor completed, Handrails – 1st to 16th floor completed.
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – sunken filling up to 12th floor completed, flush tank fixing 1st to 9th floor completed
- External Finishes – Windows and sliding doors -70% completed, External Plastering : west side completed, South side – completed, North side – completed, East side – completed, External painting – west side painting completed, North side painting completed, east side – completed
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – completed, Reticulated gas piping – 100% completed, Painting – Primer application completed
As per the current work status from our site, we are targeted to complete the following works by the end of FEBRUARY 2023.
ARTECH METROPOLIS ( TOWER -1 )
- Internal Finishes – Flooring – BF – 3, 100% to be completed, Painting – terrace 2nd coat painting work to be completed
- Electrical, Plumbing & Firefighting works – gas work 100% to be completed.
- Final Finishes – Door shutter fixing – 5 more flats to be completed, painting- two coat painting – 10 more flats to be completed, plumbing & sanitary – 5 more flats to be completed, Eletrical final fittings – 10 more flats to be completed, Fire fighting final fitting – 14 more flats to be completed
- External Finishes – Windows and sliding doors – 100% to be completed, External painting – 2nd coat painting 75% to be completed.
ARTECH METROPOLIS (TOWER-2)
- Internal Finishes – Flooring – 1st floor 30% more to be completed, 5th Floor – 30% more to be completed and 6th floor – 75% to be completed, Wall Tile work – 5th floor 100% to be completed, putty works and painting – 12th floor 2 coat putty and 2 coat primer 100% to be completed, 13th to 16th floor 1st coat putty to be completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – flush tank fixing 13th to 15th floor to be completed
- External Finishes – Windows and sliding doors -30% more to be completed
Work status as on 14-01-2023, we have completed the following.
ARTECH METROPOLIS ( TOWER -1 )
- Structural Works – All sub-structural and structural works- completed
- Civil Works – Completed
- Internal Finishes – Main door – completed, Waterproofing- completed, Wall tiling – BF -1, G/F to 17th floor completed, BF -2, 95% completed, Flooring – BF – 1 completed, G/F to 17th floor completed (99% completed), BF – 2, 95% completed, BF – 3, 90% completed, Terrace completed, putty works & Painting- 1st Floor to 17th Floor Flat inside 1st and 2nd coat putty and one coat primer completed, GF and terrace 2nd coat putty and primer work completed, BF -3 Floor to 17th Floor stair and passage 2nd coat putty and one coat primer completed, Terrace 1st coat painting completed, GF to 11th floor passage 1st coat painting completed, Door frame fixtures- BF 2 to 4th Floor completed, Handrails- completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – G/F to Terrace completed, BF – 1 Completed, BF -2 Completed, Corridor handrail works – completed, Wall and floor services, Risers, – completed, Centralised Gas piping system – 90% completed (GF to 17th floor)
- Final Finishes – Door shutters & ironmongery, – 65 flats completed, Final Painting – Two coat painting 43 flats completed, Plumbing & Sanitaryware – 44 flats completed, Electrical final fixtures – 48 flats completed, Firefighting final fixtures – 47 flats completed
- External Finishes – Windows & Sliding doors – 90% completed, External Plastering- completed, External Painting – 1st coat painting 90% completed
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – completed, Reticulated gas piping – 100% completed, Painting – 100% completed
ARTECH METROPOLIS (TOWER-2)
- Structural Works – Pile cap – completed , slab completed – upto terrace Floor completed, All pergola completed, terrace Parapet completed, Lift machine room base and cover slab completed, stair case head room completed, OH tank base, wall and cover slab completed
- Civil Works – Ceiling plaster completed, wall plastering upto 16th floor completed, machine room plastering – completed, Masonry – Block/ brick completed, BF – 16th floor completed.
- Internal Finishes – Waterproofing – 1st to 15th floor completed, Flooring – sample flat completed, 1st floor – 70% completed, 2nd floor – 70% completed, 5th floor – 70% completed, wall tiling – 1st floor – 80% completed, 2nd floor – 75% completed, 3rd floor – 25% completed, 5th floor – 50% completed, putty works & Painting- 1st to 11th floor 2 coat putty and 2 coat primer completed, 12th floor – 50% completed, Door frame fixtures – Main door frame – BF -3 to 16th floor completed, Handrails – 1st to 16th floor completed.
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – sunken filling up to 12th floor completed, flush tank fixing 1st to 9th floor completed
- External Finishes – Windows and sliding doors -70% completed, External Plastering : west side completed, South side – completed, North side – completed, East side – completed, External painting – west side painting completed, North side painting completed, east side – completed
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – completed, Reticulated gas piping – 100% completed, Painting – Primer application completed
As per the current work status from our site, we are targeted to complete the following works by the end of JANUARY 2023.
ARTECH METROPOLIS ( TOWER -1 )
- Internal Finishes – Wall tiling – BF -2, 100% to be completed, Flooring – BF – 2, 100% to be completed, BF – 3, 100% to be completed, Painting – 11th to terrace stair and passage 1st coat painting work to be completed, Fire stair, Main stair rail one coat primer and one coat painting work to be completed
- Electrical, Plumbing & Firefighting works – gas work 100% to be completed.
- Final Finishes – Door shutter fixing – 11 more flats to be completed, painting- two coat painting – 10 more flats to be completed, plumbing & sanitary – 5 more flats to be completed, Eletrical final fittings – 10 more flats to be completed, Fire fighting final fitting – 15 more flats to be completed
- External Finishes – Windows and sliding doors – 100% to be completed, External painting – 1st coat painting 100% to be completed, 2nd coat painting 90% to be completed.
ARTECH METROPOLIS (TOWER-2)
- Internal Finishes – water proofing – 16th floor to be completed, Flooring – 1st floor 30% more to be completed, 5th Floor – 30% more to be completed and 6th floor – 75% to be completed, Wall Tile work – 5th floor 100% to be completed, putty works and painting – 12th floor 2 coat putty and 2 coat primer 100% to be completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – flush tank fixing 13th to 15th floor to be completed
- External Finishes – Windows and sliding doors -30% more to be completed
Work status as on 13-12-2022, we have completed the following
As per the current work status from our site, we are targeted to complete the following works by the end of DECEMBER 2022.
ARTECH METROPOLIS ( TOWER -1 )
- Internal Finishes – Wall tiling – BF -2, 100% to be completed, Flooring – BF – 2, 100% to be completed, BF – 3, 100% to be completed, Painting – 11th to terrace stair and passage 1st coat painting work to be completed, Fire stair, Main stair rail one coat primer and one coat painting work to be completed
- Electrical, Plumbing & Firefighting works – gas work 100% to be completed.
- Final Finishes – Door shutter fixing – 5 more flats to be completed, painting- two coat painting – 5 more flats to be completed, plumbing & sanitary – 5 more flats to be completed, Eletrical final fittings – 5 more flats to be completed, Fire fighting final fitting – 5 more flats to be completed
- External Finishes – Windows and sliding doors – 100% to be completed, External painting – 1st coat painting 100% to be completed, 2nd coat painting 60% to be completed.
ARTECH METROPOLIS (TOWER-2)
- Internal Finishes – water proofing – 15th floor 100% to be completed, Flooring – 1st floor 30% more to be completed, 5th Floor – 30% more to be completed and 6th floor – 75% to be completed, Wall Tile work – 5th floor 100% to be completed, putty works and painting – 12th floor 2 coat putty and 2 coat primer 100% to be completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – flush tank fixing 13th to 15th floor to be completed
- External Finishes – Windows and sliding doors -30% more to be completed, External plastering – East side 100% to be completed, External painting – east side painting 20% more to be completed south side to be completed.
Work status as on 13-12-2022, we have completed the following.
ARTECH METROPOLIS ( TOWER -1 )
- Structural Works – All sub-structural and structural works- completed
- Civil Works – Civil works – completed
- Internal Finishes – Main door – completed, Waterproofing- completed, Wall tiling – BF -1, G/F to 17th floor completed, BF -2, 95% completed, Flooring – BF – 1 completed, G/F to 17th floor completed (99% completed), BF – 2, 95% completed, BF – 3, 90% completed, Terrace completed, putty works & Painting- 1st Floor to 17th Floor Flat inside 1st and 2nd coat putty and one coat primer completed, GF and terrace 2nd coat putty and primer work completed, BF -3 Floor to 17th Floor stair and passage 2nd coat putty and one coat primer completed, Terrace 1st coat painting completed, GF to 11th floor passage 1st coat painting completed, Door frame fixtures- BF 2 to 4th Floor completed, Handrails- completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – G/F to Terrace completed, BF – 1 Completed, BF -2 Completed, Corridor handrail works – completed, Wall and floor services, Risers, – completed, Centralised Gas piping system – 90% completed (GF to 17th floor)
- Final Finishes – Door shutters & ironmongery, – 55 flats completed, Final Painting – Two coat painting 39 flats completed, Plumbing & Sanitaryware – 39 flats completed, Electrical final fixtures – 41 flats completed, Firefighting final fixtures – 37 flats completed
- External Finishes – Windows & Sliding doors – 90% completed, External Plastering- completed, External Painting – 1st coat painting 90% completed
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – completed, Reticulated gas piping – 100% completed, Painting – 100% completed
ARTECH METROPOLIS (TOWER-2)
- Structural Works – Pile cap – completed , slab completed – upto terrace Floor completed, All pergola completed, terrace Parapet completed, Lift machine room base and cover slab completed, stair case head room completed, OH tank base, wall and cover slab completed
- Civil Works – Ceiling plaster completed, wall plastering upto 16th floor completed, machine room plastering – completed, Masonry – Block/ brick completed, BF – 16th floor completed.
- Internal Finishes – Waterproofing – 1st to 14th floor completed, 15th floor – 50% completed, Flooring – sample flat completed, 1st floor – 70% completed, 2nd floor – 70% completed, 5th floor – 70% completed, wall tiling – 1st floor – 80% completed, 2nd floor – 75% completed, 3rd floor – 25% completed, 5th floor – 50% completed, putty works & Painting- 1st to 11th floor 2 coat putty and 2 coat primer completed, 12th floor – 50% completed, Door frame fixtures – Main door frame – BF -3 to 16th floor completed, Handrails – 1st to 16th floor completed.
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – sunken filling up to 12th floor completed, flush tank fixing 1st to 9th floor completed
- External Finishes – Windows and sliding doors -70% completed, External Plastering : west side completed, South side – completed, North side – completed, East side – 90% completed, External painting – west side painting completed, North side painting completed, east side – 80% completed
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – Primer application completed
As per the current work status from our site, we are targeted to complete the following works by the end of NOVEMBER 2022.
ARTECH METROPOLIS ( TOWER -1 )
- Internal Finishes – Wall tiling – BF -2, 100% to be completed, Flooring – BF – 2, 100% to be completed, BF – 3, 30% more to be completed, Painting – GF to terrace stair and passage 1st coat painting work to be completed, Fire stair, Main stair rail one coat primer and one coat painting work to be completed
- Electrical, Plumbing & Firefighting works – gas work 100% to be completed.
- Final Finishes – Door shutter fixing – 5 more flats to be completed, painting- two coat painting – 5 more flats to be completed, plumbing & sanitary – 5 more flats to be completed, Eletrical final fittings – 5 more flats to be completed, Fire fighting final fitting – 5 more flats to be completed
- External Finishes – Windows and sliding doors – 10% more to be completed, External painting – 1st coat painting 100% to be completed, 2nd coat painting 30% to be completed.
ARTECH METROPOLIS (TOWER-2)
- Civil Works wall plastering : 16th floor to be completed
- Internal Finishes – water proofing – 15th floor to be completed, Flooring – 1st floor 30% more to be completed, 5th and 6th floor – 75% to be completed, Wall Tile work – 5th floor to be completed, putty works and painting – 12th floor 2 coat putty and 2 coat primer 100% to be completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – flush tank fixing 13th to 15th floor to be completed
- External Finishes – Windows and sliding doors -30% more to be completed, External plastering – East side 100% to be completed, south side 100% to be completed, External painting – east side painting to be completed.
Work status as on 15-11-2022, we have completed the following.
ARTECH METROPOLIS ( TOWER -1 )
- Structural Works – All sub-structural and structural works- completed
- Civil Works – Civil works – completed
- Internal Finishes – Main door – completed, Waterproofing- completed, Wall tiling – BF -1, G/F to 17th floor completed, BF -2, 95% completed, Flooring – BF – 1, G/F to 17th floor completed (99% completed), BF – 2, 95% completed, BF – 3, 70% completed, Terrace completed, putty works & Painting- 1st Floor to 17th Floor Flat inside 1st and 2nd coat putty and one coat primer completed, GF and terrace 2nd coat putty and primer work completed, BF -3 Floor to 17th Floor stair and passage 2nd coat putty and one coat primer completed, Terrace 1st coat painting completed, Door frame fixtures- BF 2 to 4th Floor completed, Handrails- completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – G/F to Terrace completed, BF – 1 Completed, BF -2 Completed, Corridor handrail works – completed, Wall and floor services, Risers, – completed, Centralised Gas piping system – 90% completed (GF to 17th floor)
- Final Finishes – Door shutters & ironmongery, – 45 flats completed, Final Painting – Two coat painting 33 flats completed, Plumbing & Sanitaryware – 39 flats completed, Electrical final fixtures – 36 flats completed, Firefighting final fixtures – 31 flats completed
- External Finishes – Windows & Sliding doors – 85% completed, External Plastering- completed, External Painting – 1st coat painting 90% completed
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – completed, Reticulated gas piping – 100% completed, Painting – 100% completed
ARTECH METROPOLIS (TOWER-2)
- Structural Works – Pile cap – completed , slab completed – upto terrace Floor completed, All pergola completed, terrace Parapet completed, Lift machine room base and cover slab completed, stair case head room completed, OH tank base, wall and cover slab completed
- Civil Works – Ceiling plaster completed, wall plastering upto 15th floor completed, machine room plastering – 50% completed, Masonry – Block/ brick completed, BF – 16th floor completed.
- Internal Finishes – Waterproofing – 1st to 14th floor completed, Flooring – sample flat completed, 1st floor – 70% completed, 2nd floor – 70% completed, wall tiling – 1st floor – 80% completed, 2nd floor – 75% completed, putty works & Painting- 1st to 11th floor 2 coat putty and 2 coat primer completed, 12th floor – 50% completed, Door frame fixtures – Main door frame – 1st to 16th floor completed, Handrails – 1st to 16th floor completed.
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – sunken filling up to 12th floor completed, flush tank fixing 1st to 9th floor completed
- External Finishes – Windows and sliding doors -10% completed, External Plastering : west side completed, South side – 90% completed, North side – completed, East side – 90% completed, External painting – west side painting completed, North side painting completed.
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – Primer application completed
Work status as on 11-10-2022, we have completed the following.
ARTECH METROPOLIS ( TOWER -1 )
- Structural Works – All sub-structural and structural works- completed
- Civil Works – Civil works – completed
- Internal Finishes – Main door – completed, Waterproofing- completed, Wall tiling – BF -1, G/F to 17th floor completed, BF -2, 90% completed, Flooring – BF – 1, G/F to 17th floor completed (99% completed), BF – 2, 90% completed, BF – 3, 50% completed, Terrace completed, putty works & Painting- 1st Floor to 17th Floor Flat inside 1st and 2nd coat putty and one coat primer completed, GF and terrace 2nd coat putty and primer work completed, BF -3 Floor to 17th Floor stair and passage 2nd coat putty and one coat primer completed, Terrace 1st coat painting completed, Door frame fixtures- BF 2 to 4th Floor completed, Handrails- completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – G/F to Terrace completed, BF – 1 Completed, BF -2 Completed, Corridor handrail works – completed, Wall and floor services, Risers, – completed, Centralised Gas piping system – 90% completed (GF to 17th floor)
- Final Finishes – Door shutters & ironmongery, – 40 flats completed, Final Painting – Two coat painting 29 flats completed, Plumbing & Sanitaryware – 29 flats completed, Electrical final fixtures – 31 flats completed, Firefighting final fixtures – 29 flats completed
- External Finishes – Windows & Sliding doors – 80% completed, External Plastering- completed, External Painting – 1st coat painting 90% completed
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – completed, Reticulated gas piping – 100% completed, Painting – 100% completed
ARTECH METROPOLIS (TOWER-2)

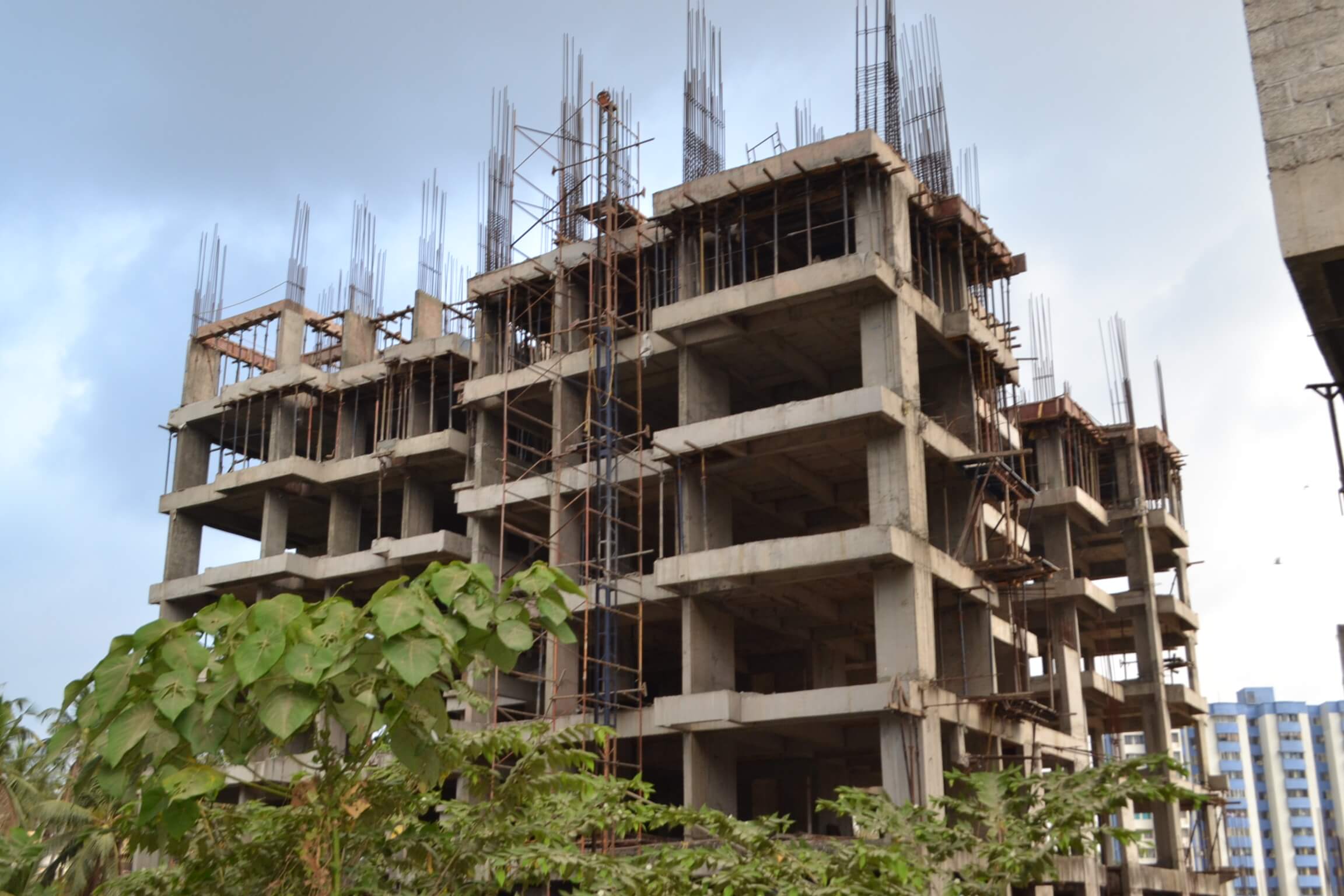

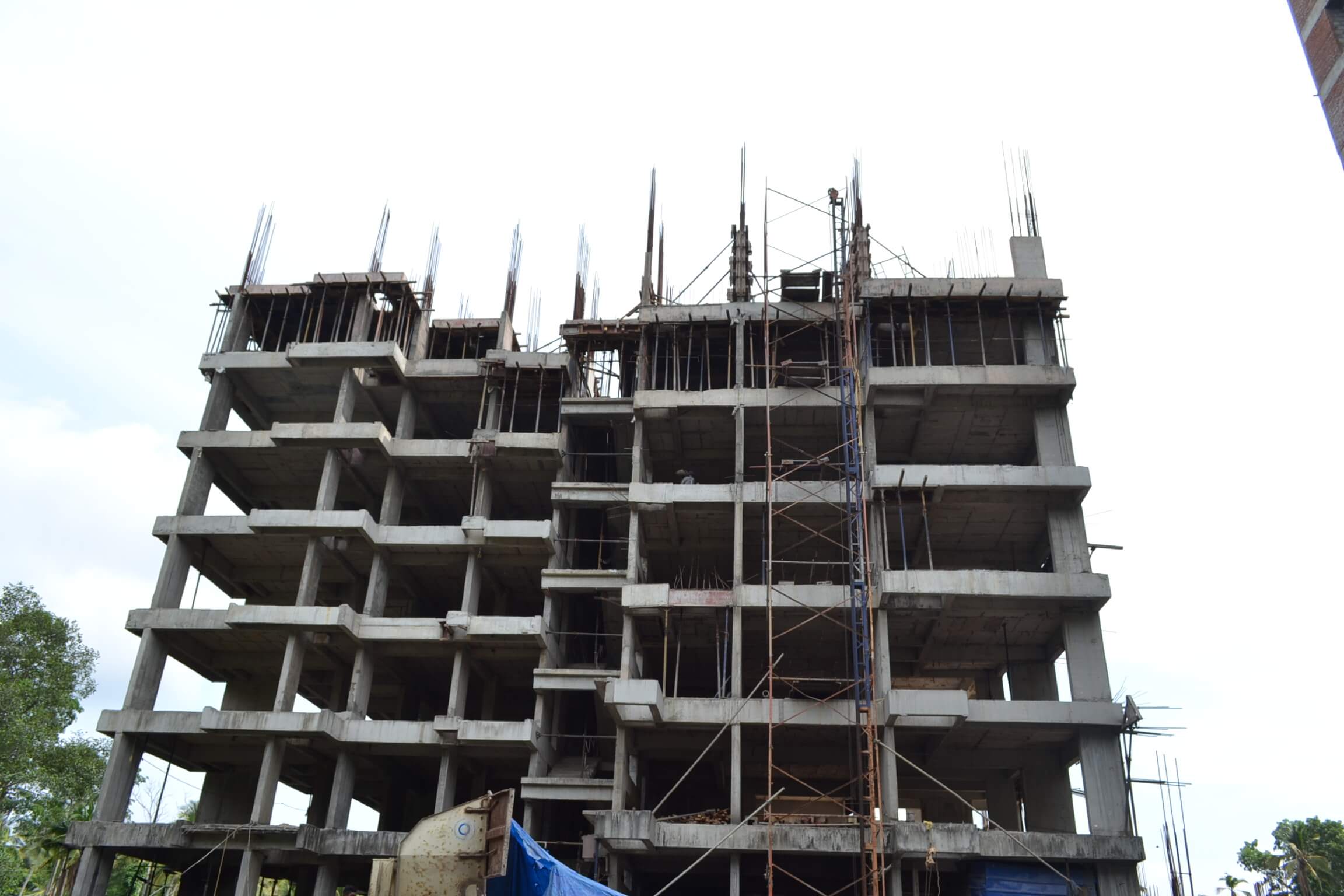

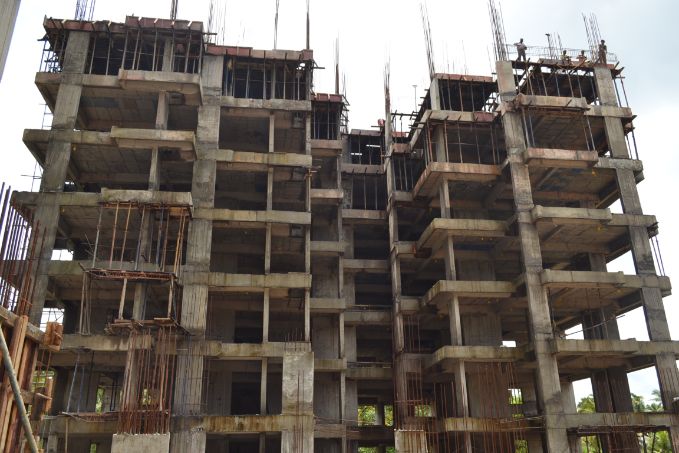

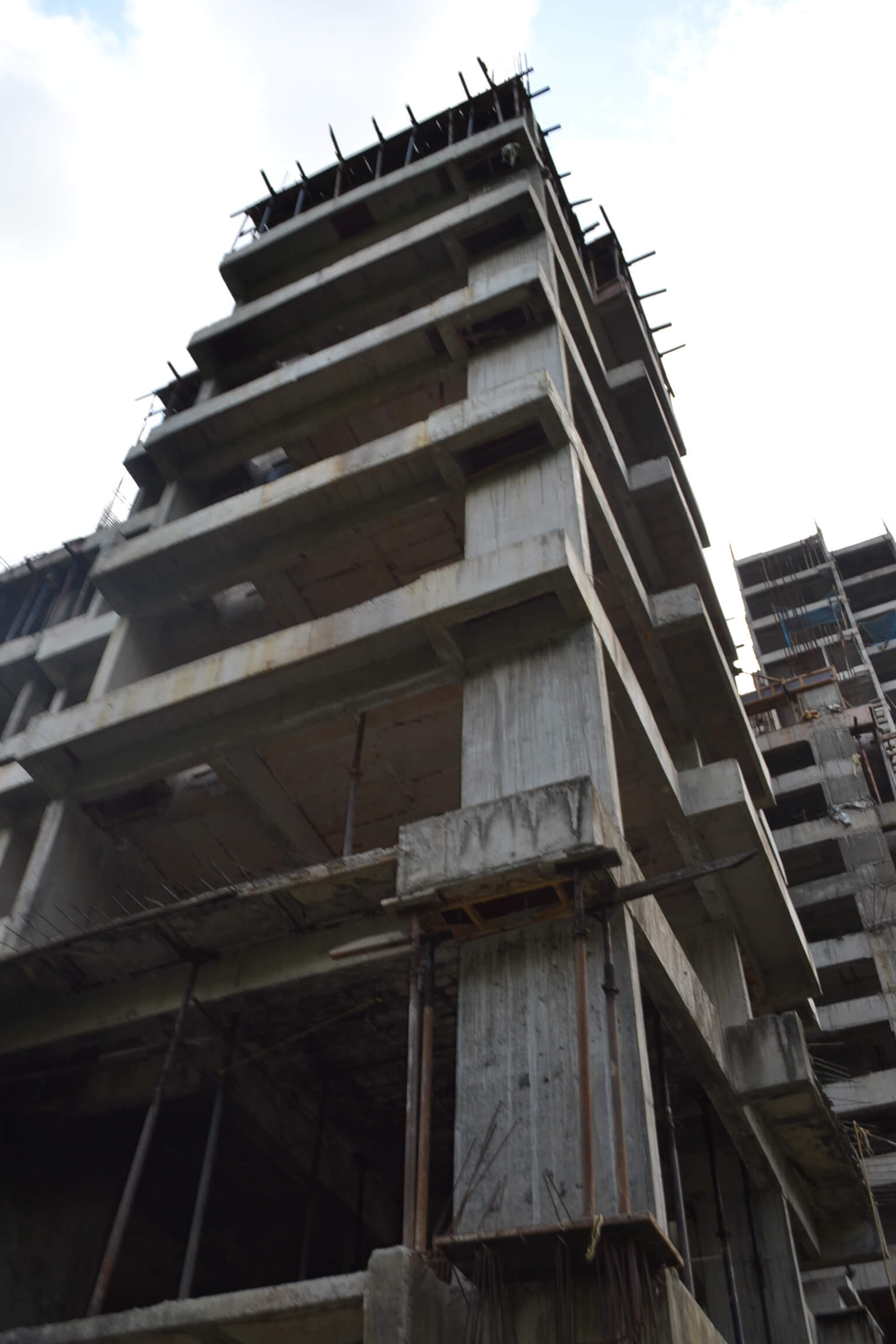

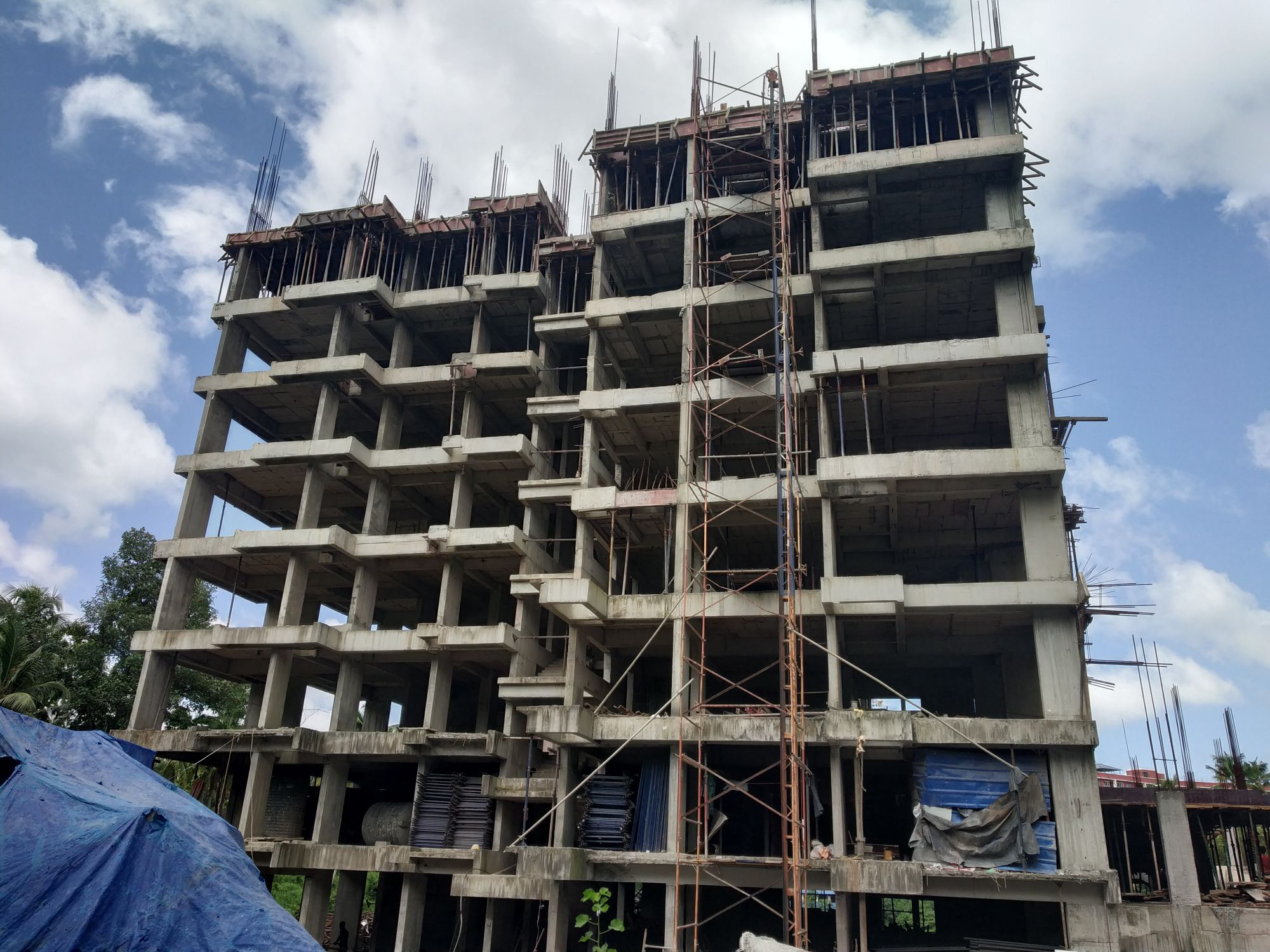

- Structural Works – Pile cap – completed , slab completed – upto terrace Floor completed, All pergola completed, terrace Parapet completed, Lift machine room base completed, stair case head room completed, OH tank base, wall and cover slab completed

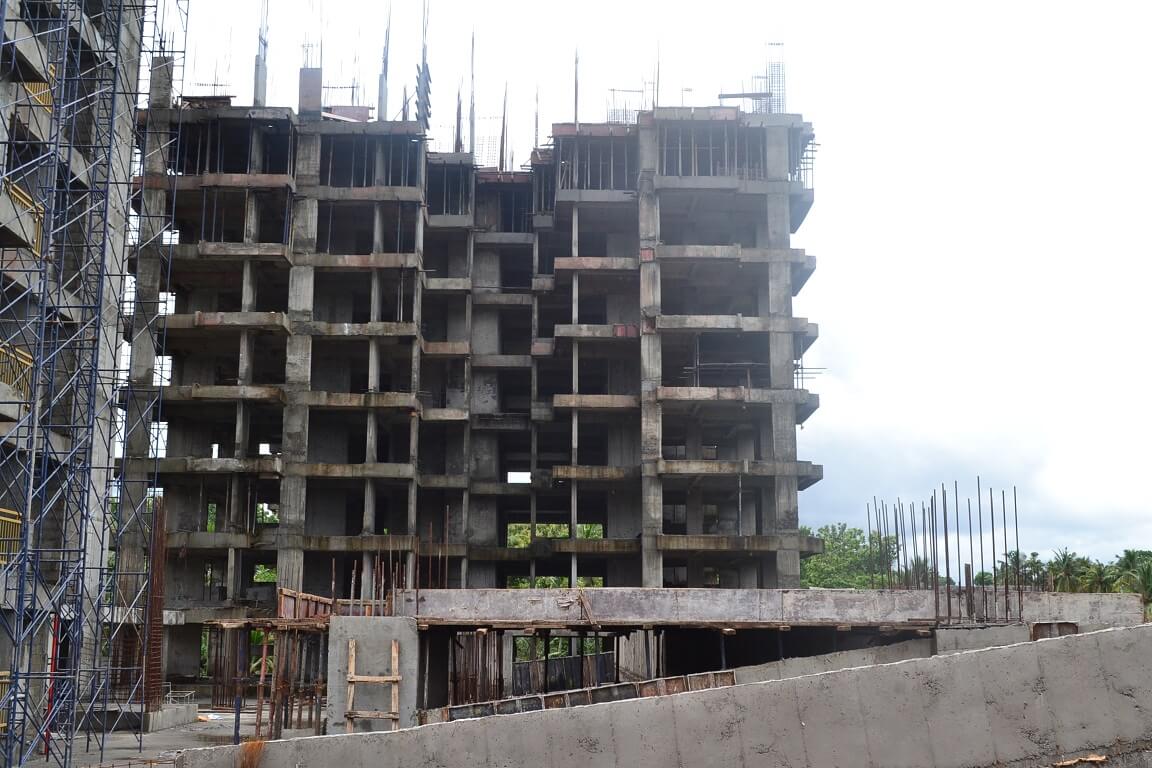

- Civil Works – Ceiling plaster completed, wall plastering upto 14th floor completed, 15th floor – 50% completed, Masonry – Block/ brick completed, BF – 16th floor completed.
- Internal Finishes – Waterproofing – 1st to 12th floor completed, 13th floor completed, Flooring – sample flat completed, 1st floor – 60% completed, putty works & Painting- 1st to 11th floor 2 coat putty and 2 coat primer completed, 12th floor – 50% completed, Door frame fixtures – Main door frame – 1st to 15th floor completed, Handrails – 1st to 16th floor completed.
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – sunken filling up to 12th floor completed, flush tank fixing 1st to 8th floor completed, Corridor firestair handrail works – BF-1 to 14th floor completed
- External Finishes – External Plastering, : west side completed, South side – 50% completed, North side – completed, East side – 90% completed, External painting – west side painting completed, North side primer and 2 coat putty – 60% completed.
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – Primer application completed
As per the current work status from our site, we are targeted to complete the following works by the end of OCTOBER 2022.
ARTECH METROPOLIS ( TOWER -1 )
- Internal Finishes – Wall tiling – BF -2, 100% to be completed, Flooring – BF – 2, 10% more to be completed, BF – 3, 30% more to be completed, Painting – BF – 3 1st coat painting work to be completed.
- Electrical, Plumbing & Firefighting works – gas work 100% to be completed.
- Final Finishes – Door shutter fixing – 5 more flats to be completed, painting- two coat painting – 5 more flats to be completed, plumbing & sanitary – 5 more flats to be completed, Eletrical final fittings – 4 more flats to be completed, Fire fighting final fitting – 5 more flats to be completed

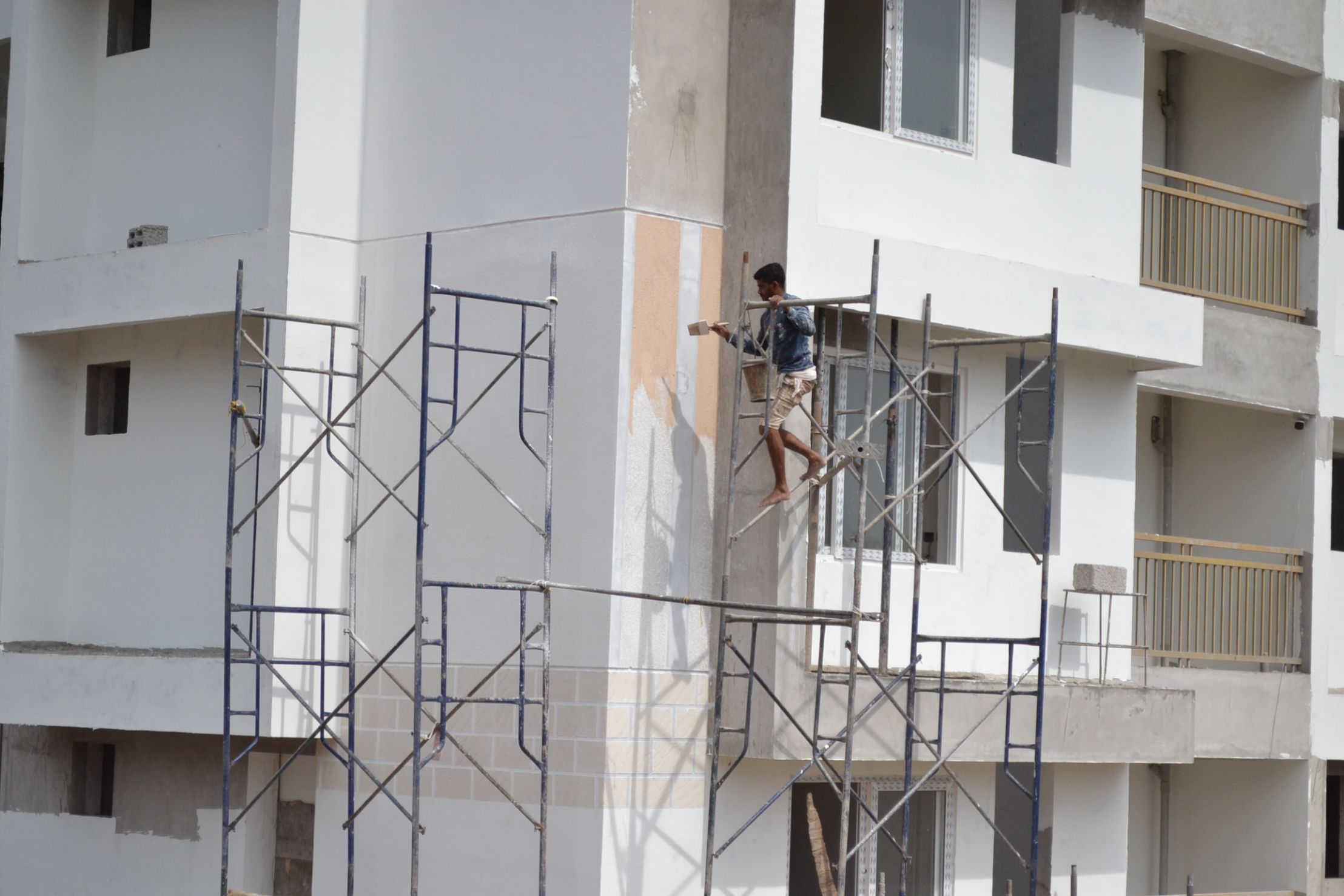

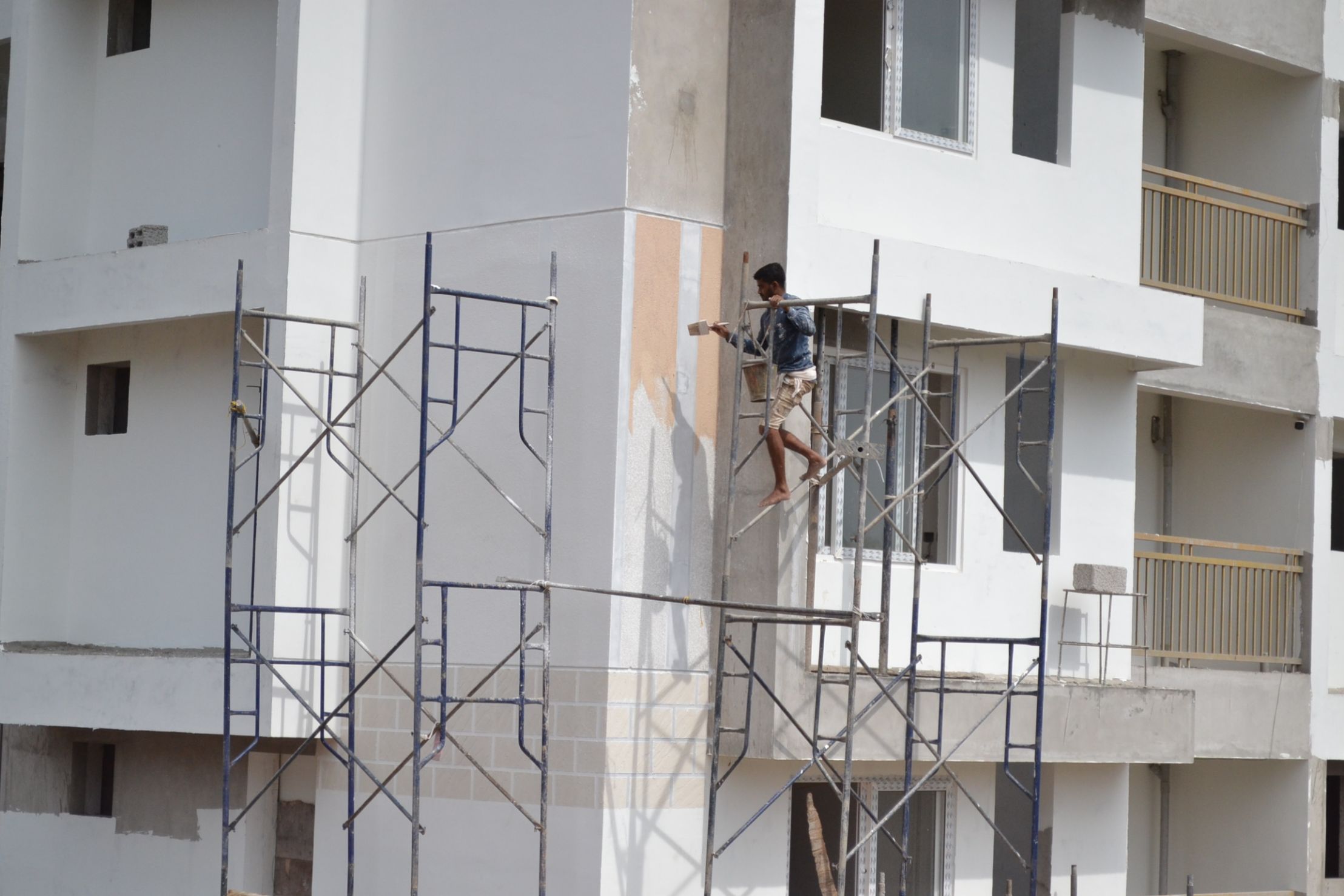

- External Finishes – External painting – 1st coat painting 100% to be completed
ARTECH METROPOLIS (TOWER-2)
- Structural Works – Machine room plastering work to be completed/li>
- Civil Works – wall plastering : 15th floor 100% to be completed
- Internal Finishes – water proofing – 14th floor 90% to be completed, Tile work – 1st floor 30% more to be completed, putty works and painting – 12th floor 2 coat putty and 2 coat primer 100% to be completed, Main door frame -16th floor 100% to be completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – flush tank fixing 9th to 12th floor to be completed, Corridor firestair handrail works – 14th floor to terrace floor to be completed
- External Finishes – External plastering – East side 100% to be completed, External painting – north side primer and 2 coat putty 100% to be completed.
Work status as on 17-09-2022, we have completed the following.
ARTECH METROPOLIS ( TOWER -1 )
- Structural Works – All sub-structural and structural works- completed
- Civil Works – Civil works – completed
- Internal Finishes – Main door – completed, Waterproofing- completed, Wall tiling – BF -1, G/F to 17th floor completed, BF -2, 70% completed, Flooring – BF – 1, G/F to 17th floor completed (99% completed), BF – 2, 90% completed, BF – 3, 50% completed, Terrace completed, putty works & Painting- 1st Floor to 17th Floor Flat inside 1st and 2nd coat putty and one coat primer completed, GF and terrace 2nd coat putty and primer work completed, BF -3 Floor to 17th Floor stair and passage 2nd coat putty and one coat primer completed, Door frame fixtures- G/F to 4th Floor completed, Handrails- completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – G/F to Terrace completed, BF – 1 Completed, BF -2 Completed, Corridor handrail works – completed, Wall and floor services, Risers, – completed, Centralised Gas piping system – 90% completed (GF to 17th floor)
- Final Finishes – Door shutters & ironmongery, – 35 flats completed, Final Painting – Two coat painting 27 flats completed, Plumbing & Sanitaryware – 25 flats completed, Electrical final fixtures – 28 flats completed, Firefighting final fixtures – 25 flats completed
- External Finishes – Windows & Sliding doors – 80% completed, External Plastering- completed, External Painting – 1st coat painting 90% completed
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – completed, Reticulated gas piping – 100% completed, Painting – 100% completed
ARTECH METROPOLIS (TOWER-2)
- Structural Works – Pile cap – completed , slab completed – upto terrace Floor completed, All pergola completed, terrace Parapet completed, Lift machine room base completed, stair case head room completed, OH tank base, wall and cover slab completed
- Civil Works – Ceiling plaster completed, wall plastering upto 14th floor completed, 15th floor – 25% completed, Masonry – Block/ brick completed, BF – 16th floor completed.
- Internal Finishes – Waterproofing – 1st to 12th floor completed, 13th floor – 25% completed, putty works & Painting- 1st to 11th floor 2 coat putty and 2 coat primer completed , Door frame fixtures – Main door frame – 1st to 15th floor completed, Handrails – 3rd to 16th floor completed.
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – sunken filling up to 11th floor completed, flush tank fixing 1st to 8th floor completed
- External Finishes – External Plastering, : west side completed, South side – 50% completed, North side – completed, East side – 40% completed, External painting – west side painting completed
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – Primer application completed
As per the current work status from our site, we are targeted to complete the following works by the end of SEPTEMBER 2022.
ARTECH METROPOLIS ( TOWER -1 )
- Internal Finishes – Wall tiling – BF -2, 100% to be completed, Flooring – BF – 2, 10% more to be completed, BF – 3, 30% more to be completed, Painting – BF -3 to terrace 1st coat painting work to be completed.
- Electrical, Plumbing & Firefighting works – gas work 100% to be completed.
- Final Finishes – Door shutter fixing – 5 more flats to be completed, painting- two coat painting – 4 more flats to be completed, plumbing & sanitary – 4 more flats to be completed, Eletrical final fittings – 4 more flats to be completed, Fire fighting final fitting – 4 more flats to be completed

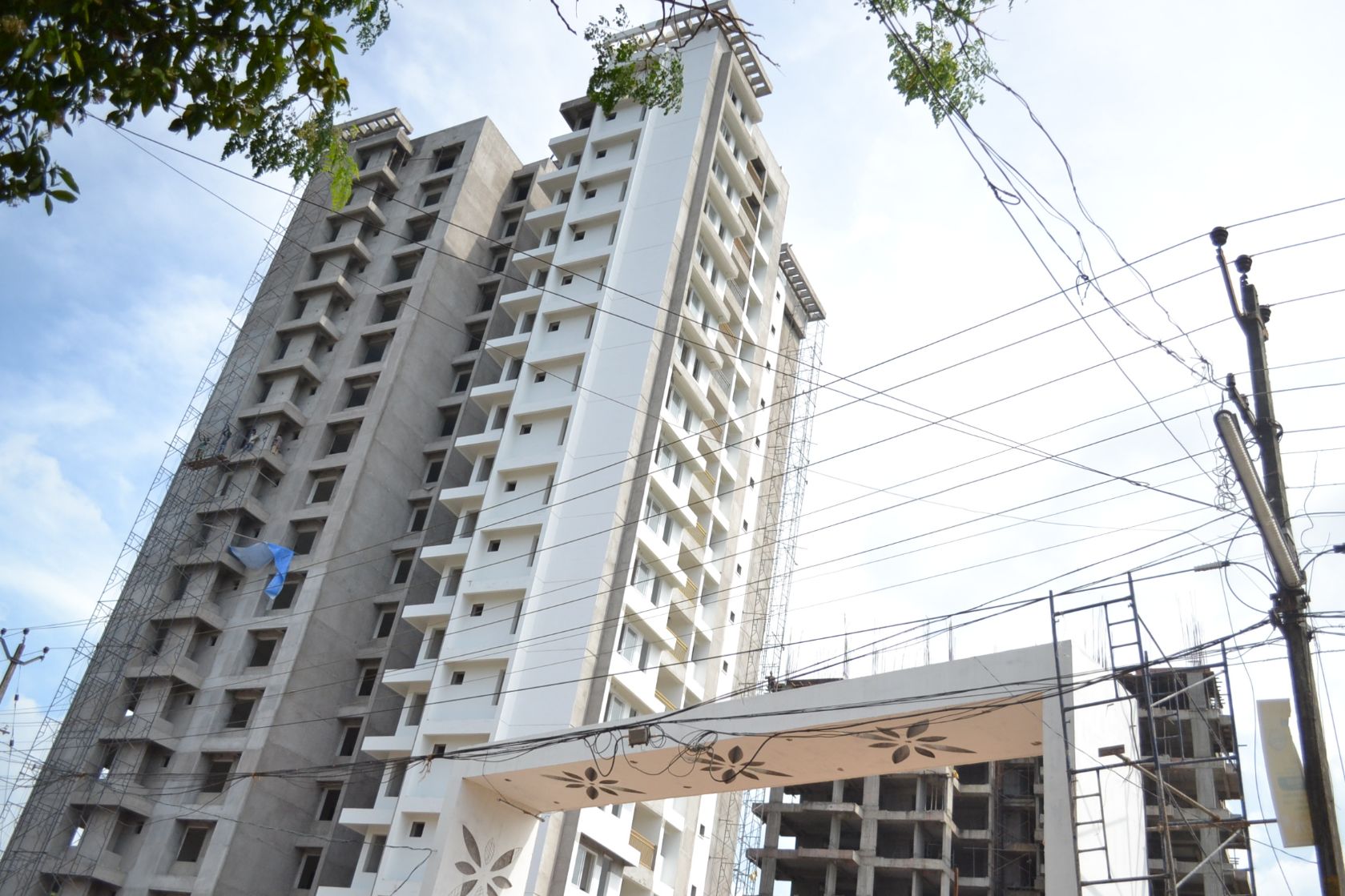

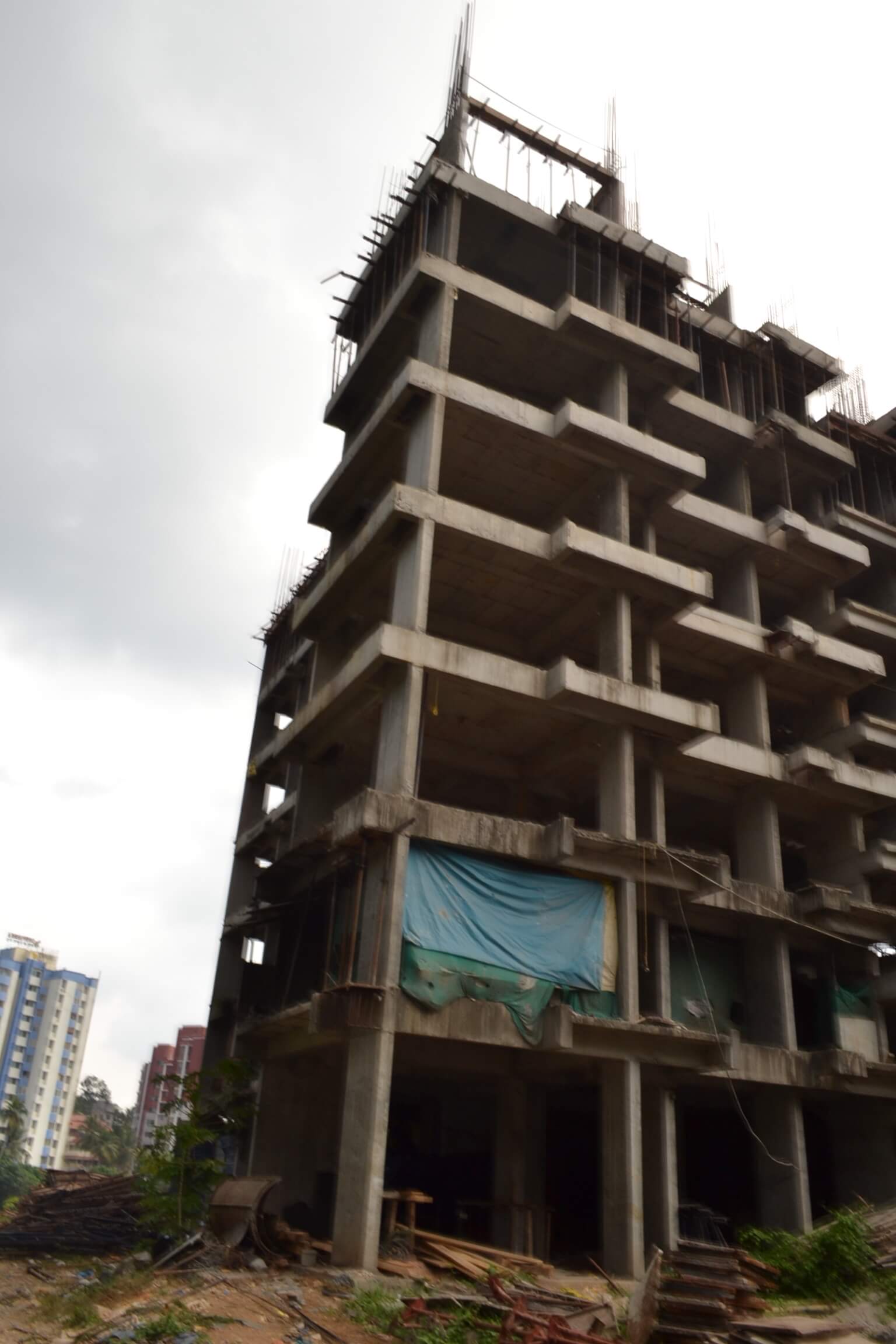

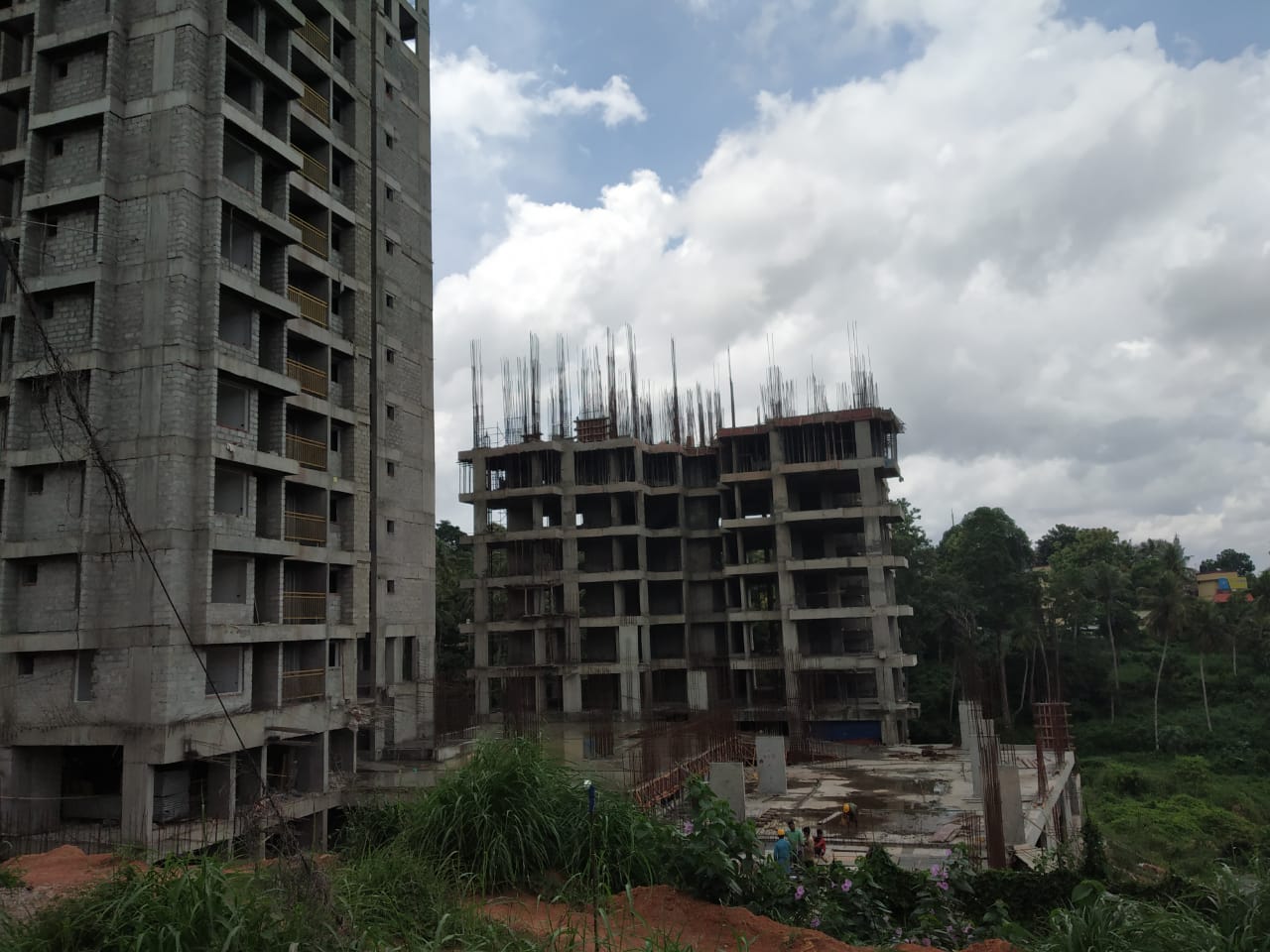

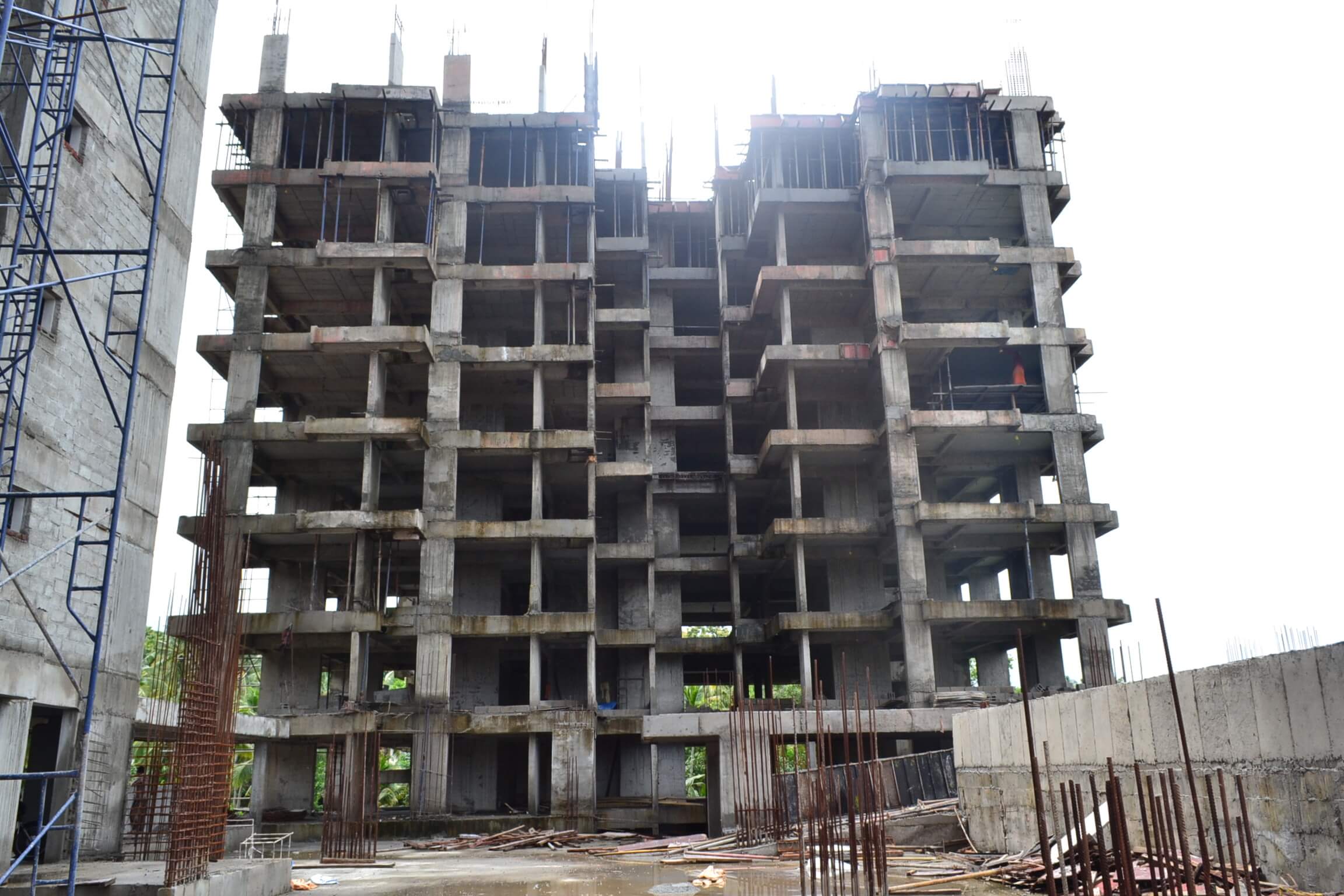

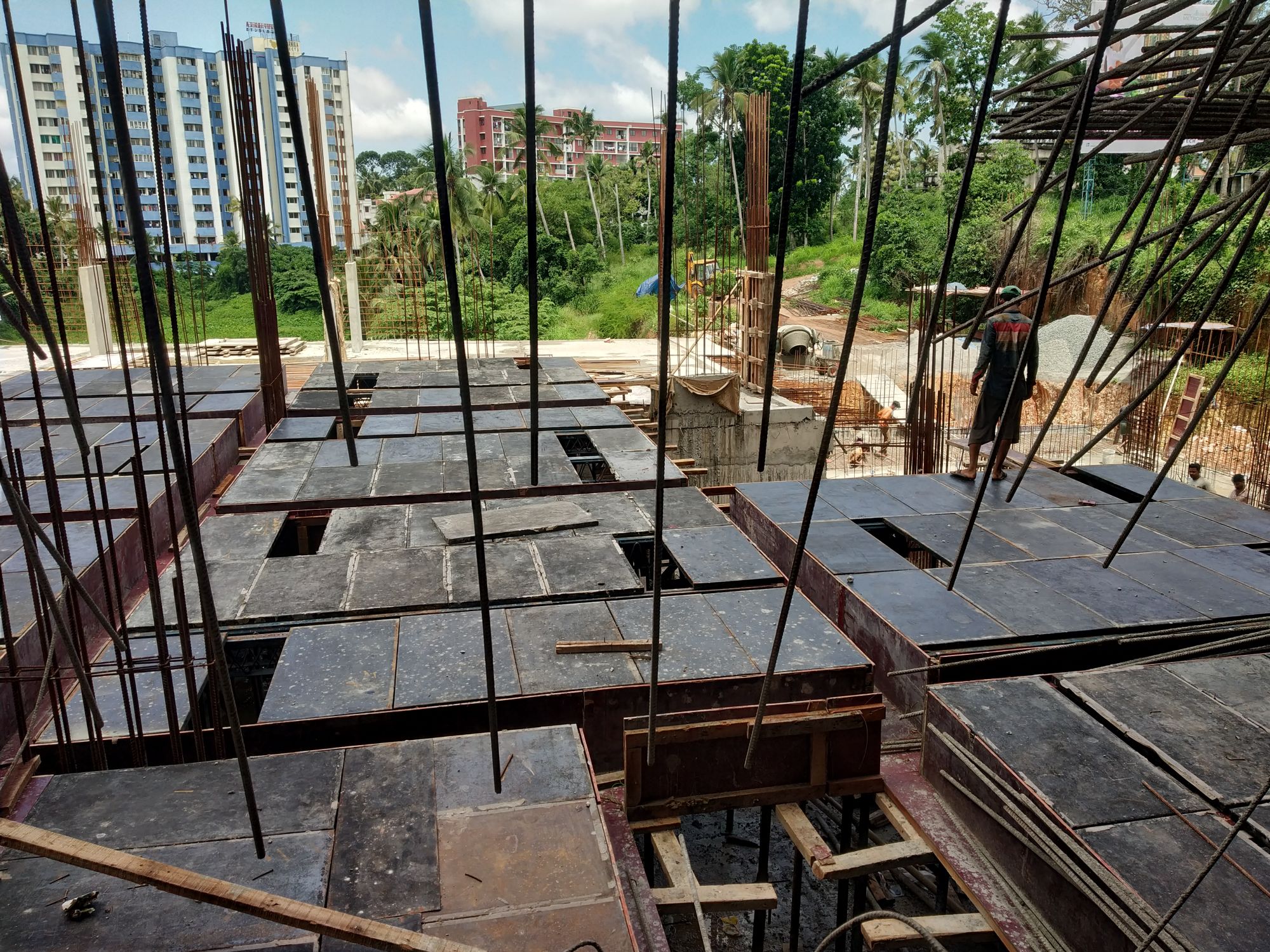

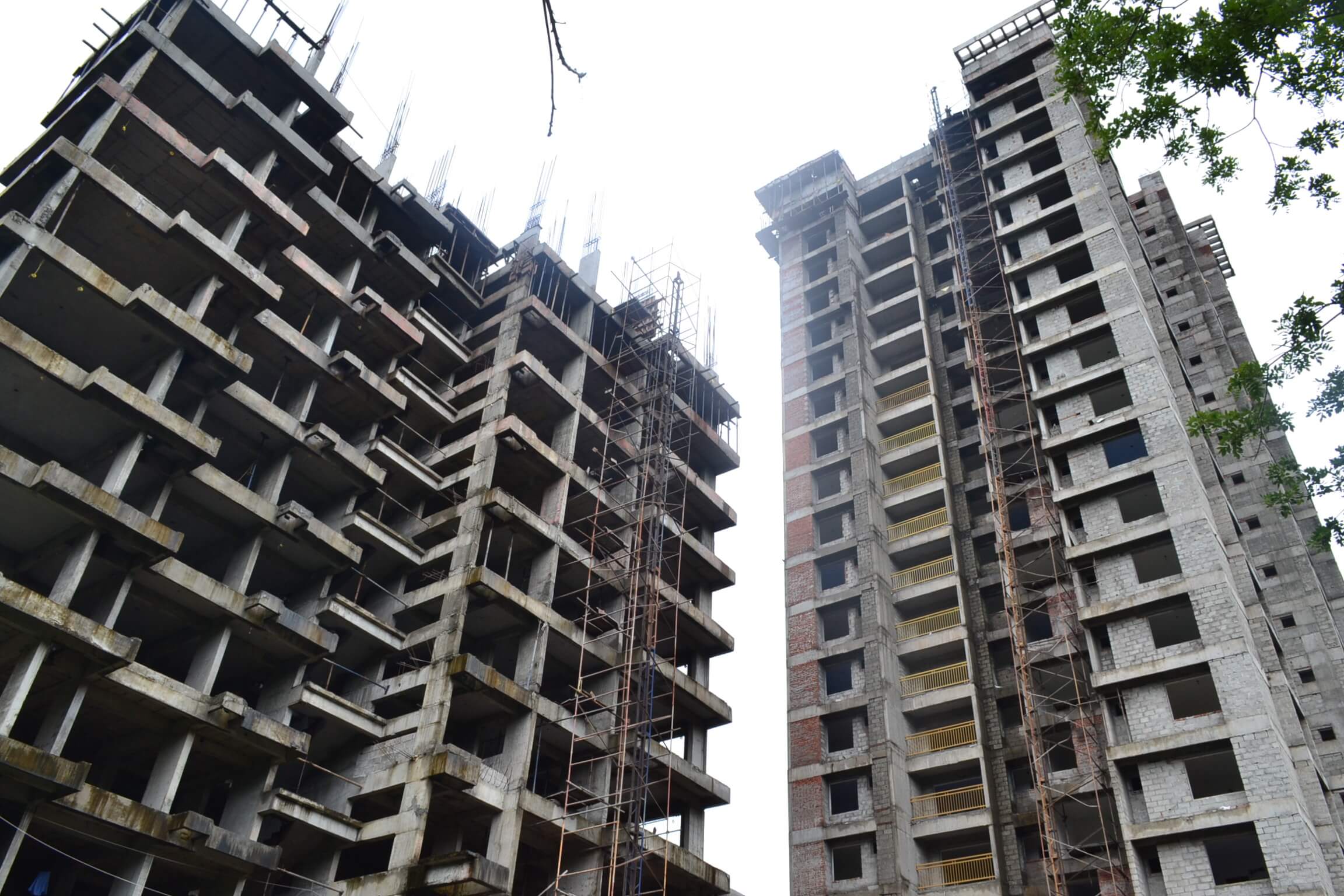

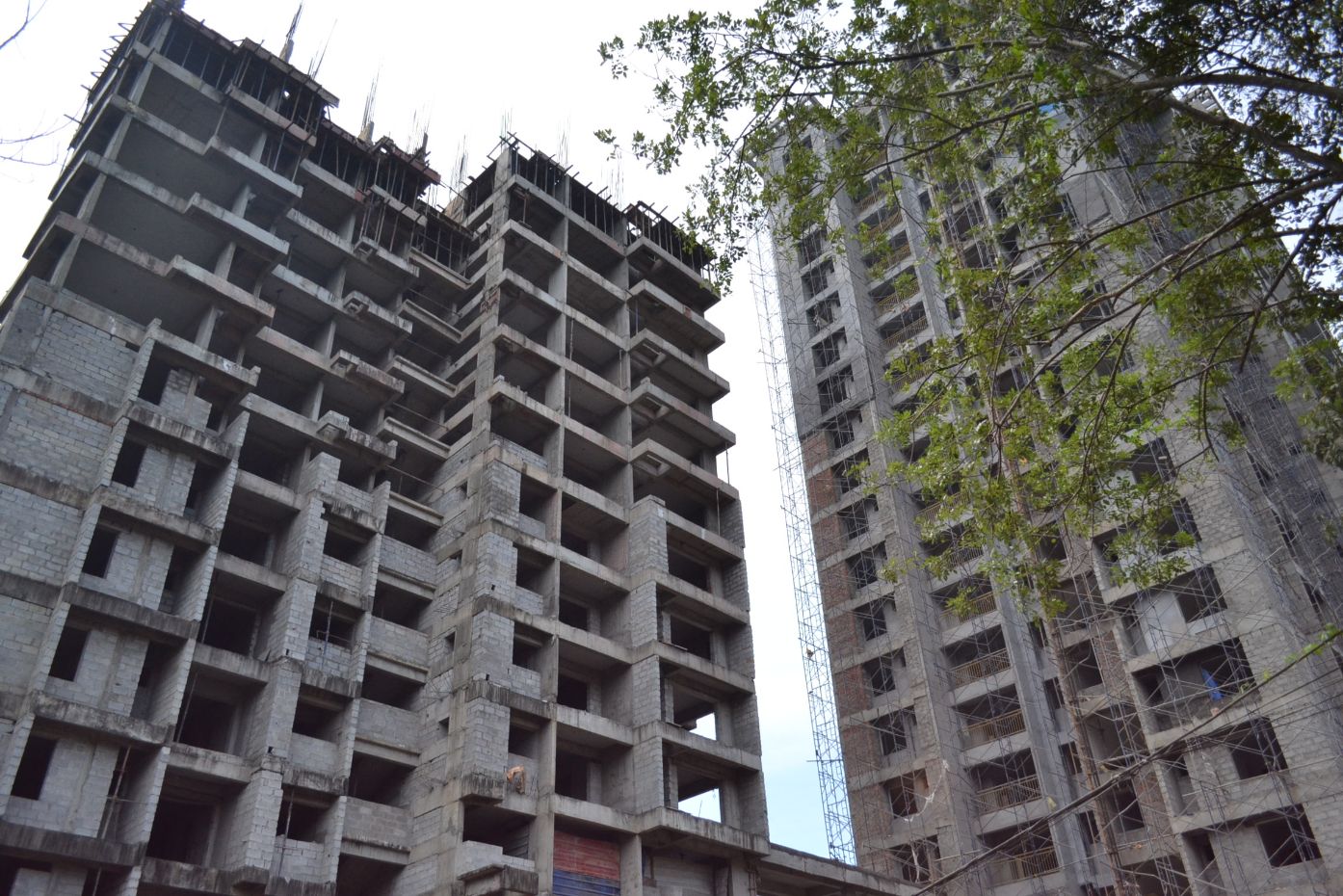

- External Finishes – External painting – 1st coat painting 100% to be completed

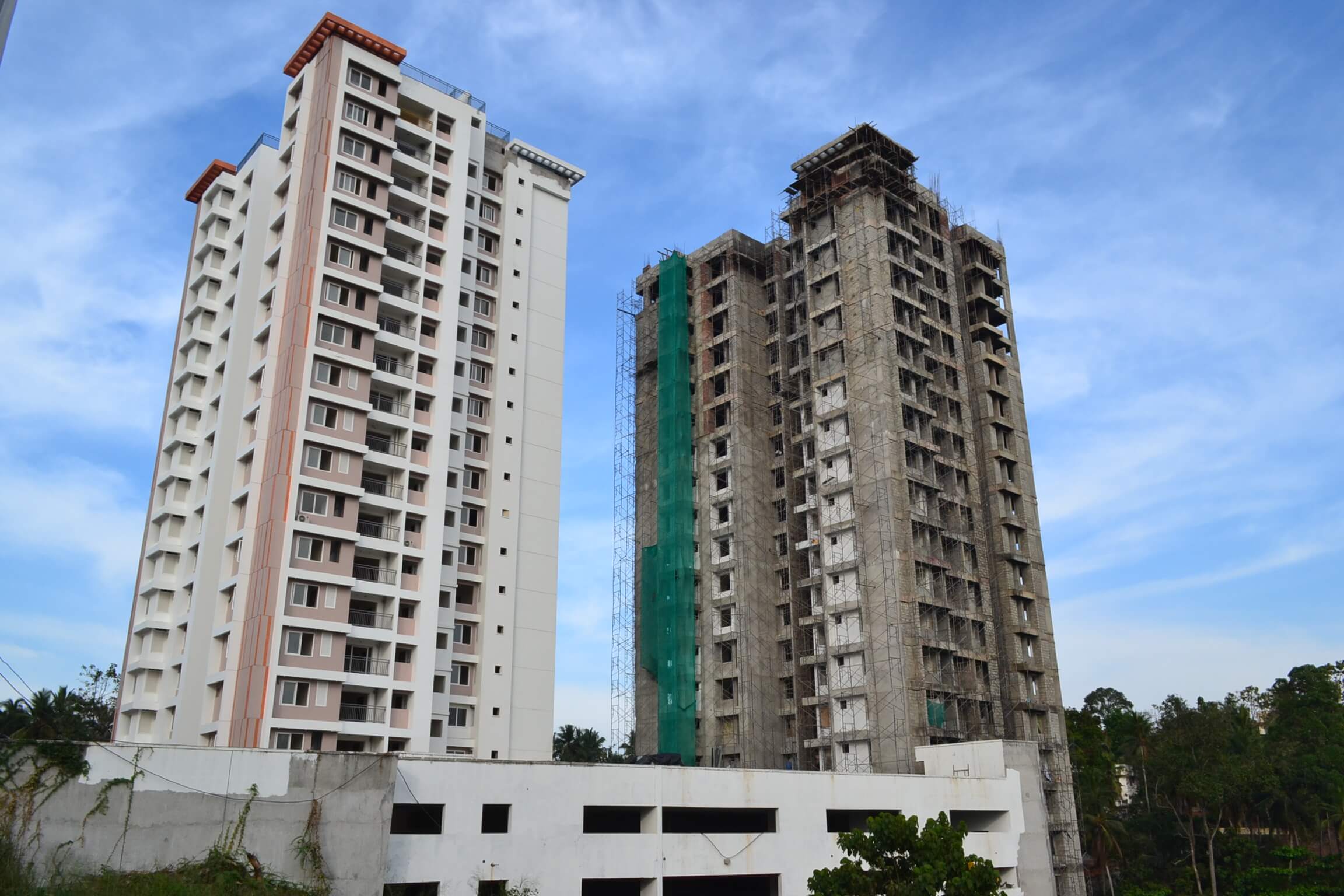

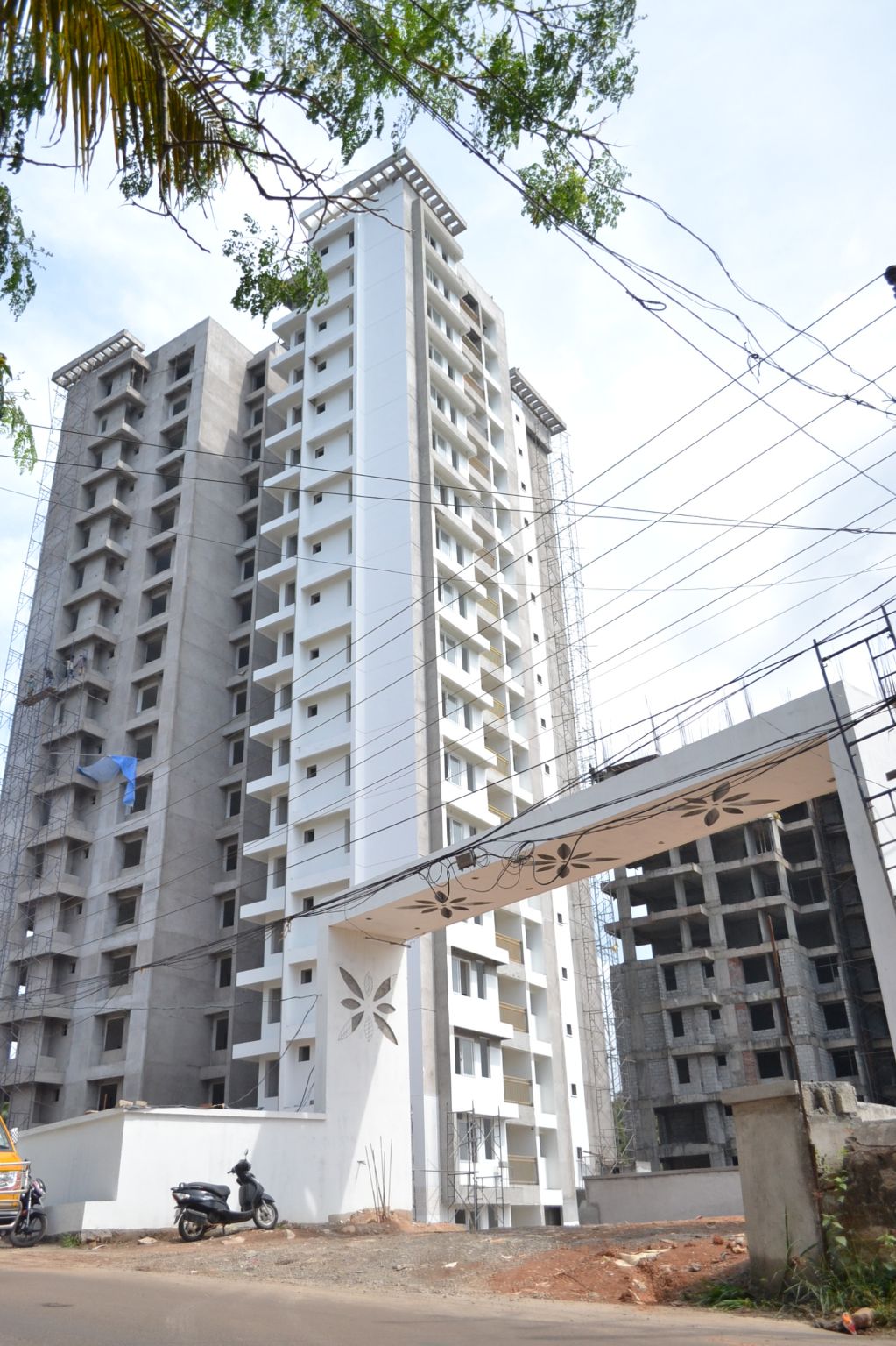

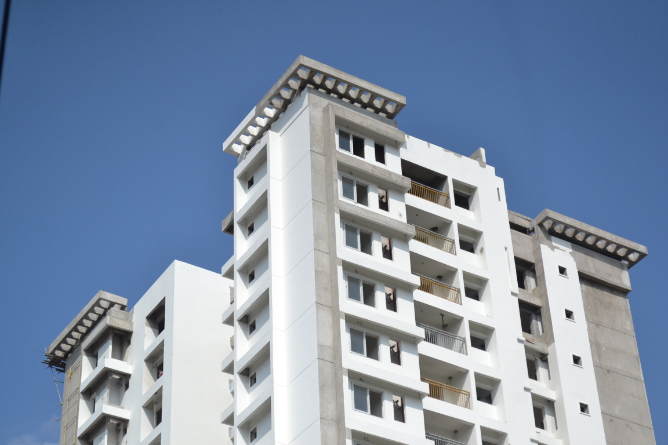

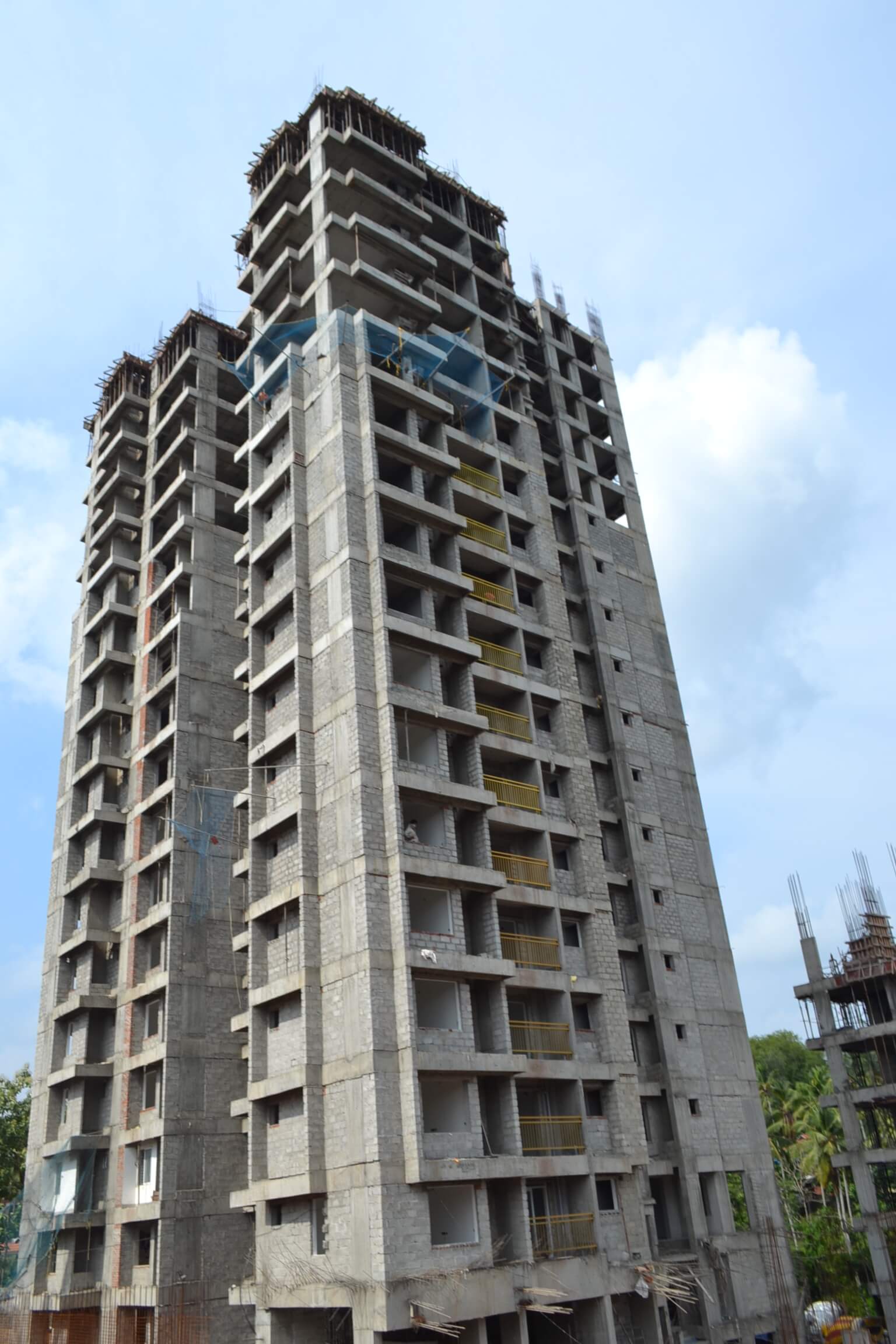

ARTECH METROPOLIS (TOWER-2)
- Structural Works – Machine room plastering work to be completed
- Civil Works – wall plastering : 15th floor 75% to be completed
- Internal Finishes – water proofing -13th floor 75% to be completed, putty works and painting – 12th floor 2 coat putty and 2 coat primer 100% to be completed, Main door frame -16th floor 100% to be completed, Tile work – 1st floor 65% to be completed

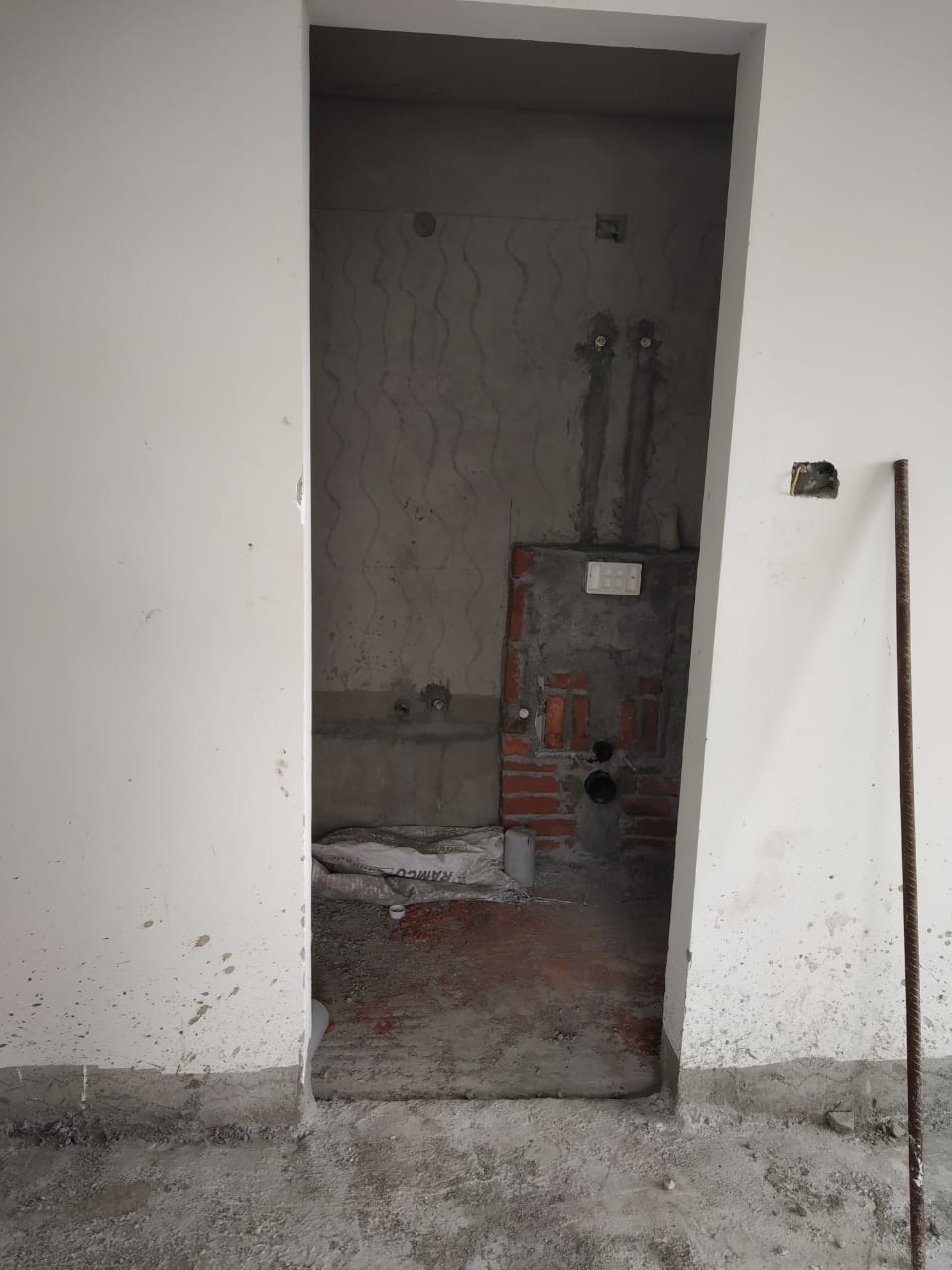

- Electrical, Plumbing & Firefighting works – Concealed plumbing works – 9th to 12th floor to be completed
- External Finishes – External plastering – East side 60% to be completed, External painting – north side primer and 2 coat putty to be completed.

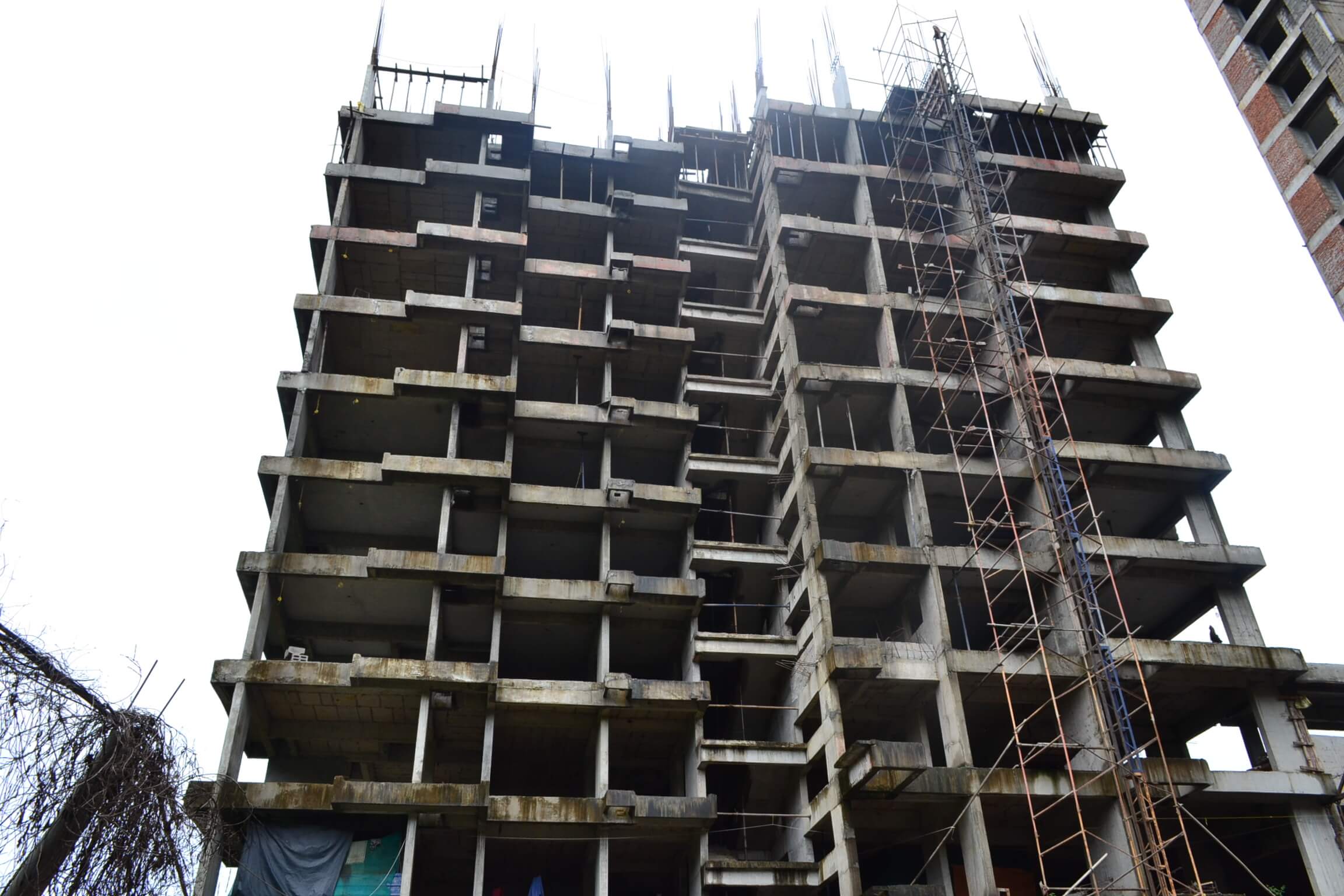

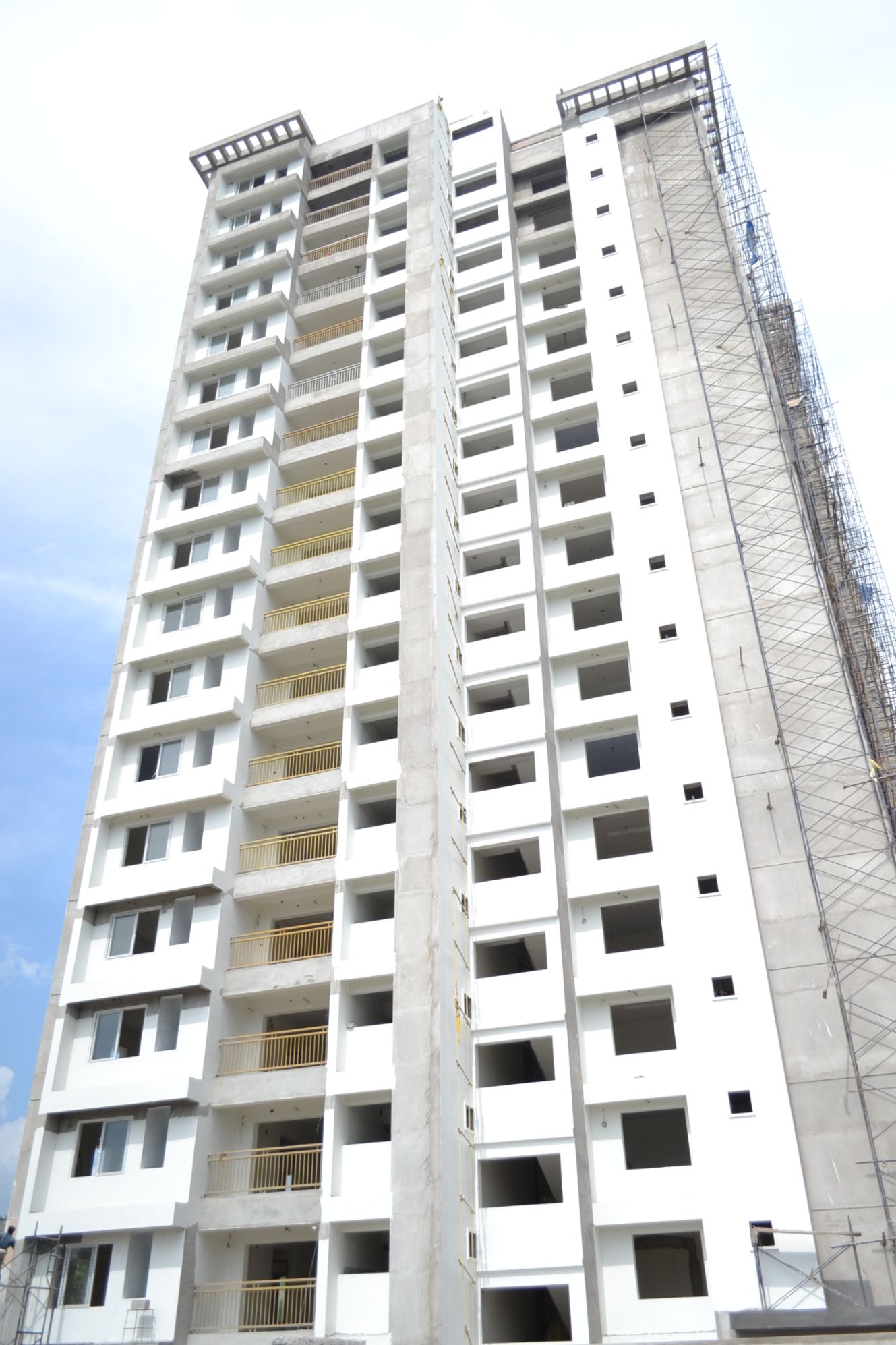

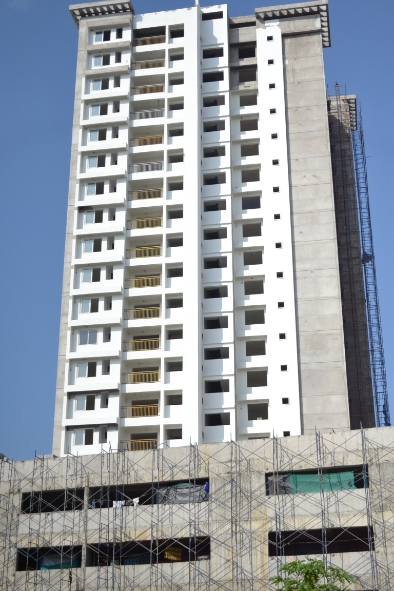

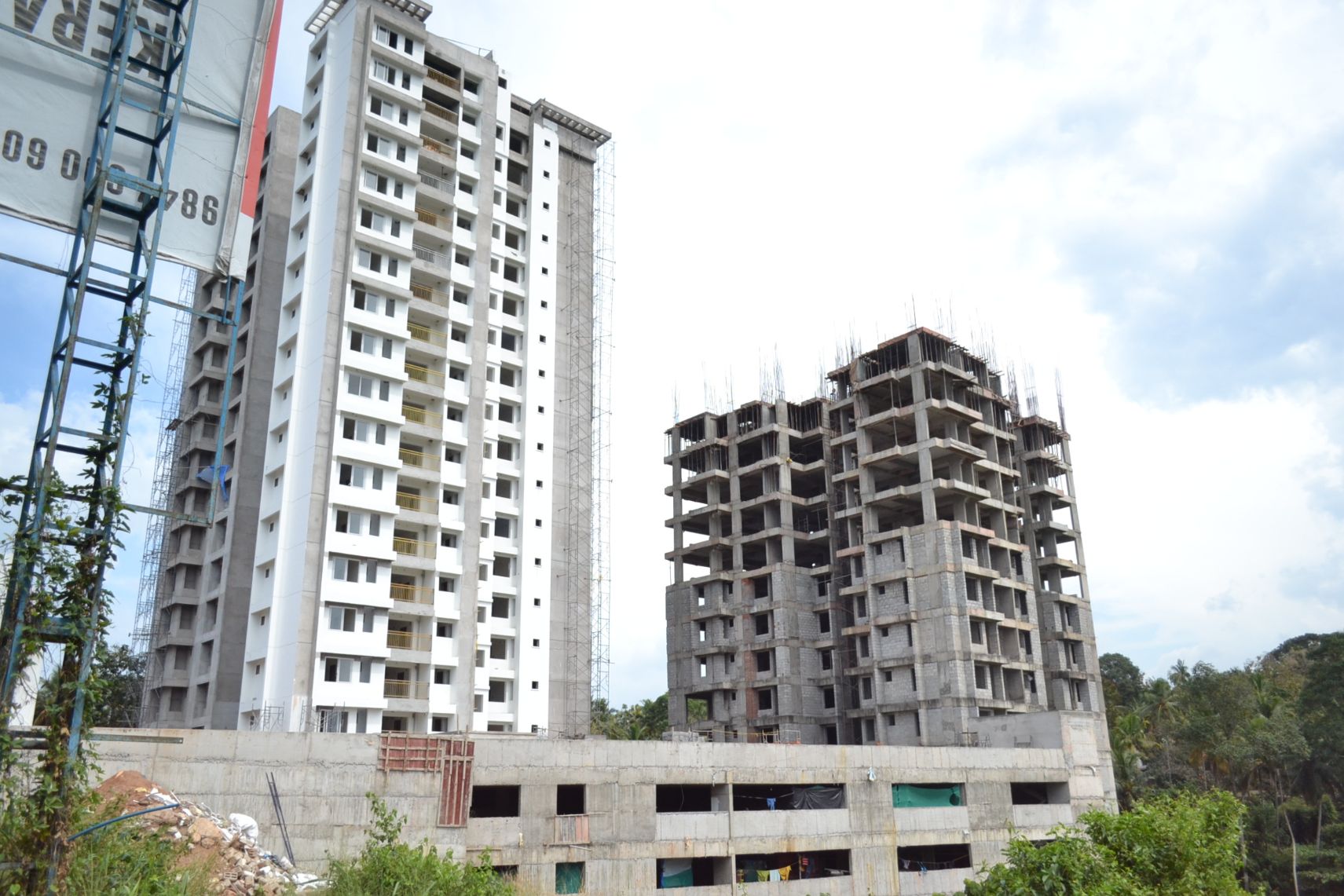

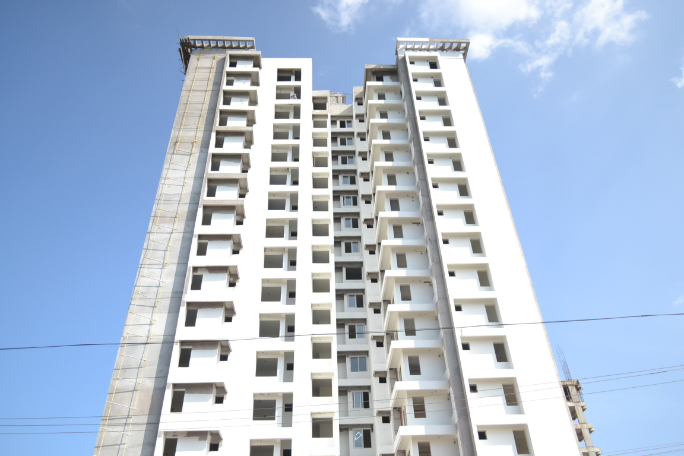

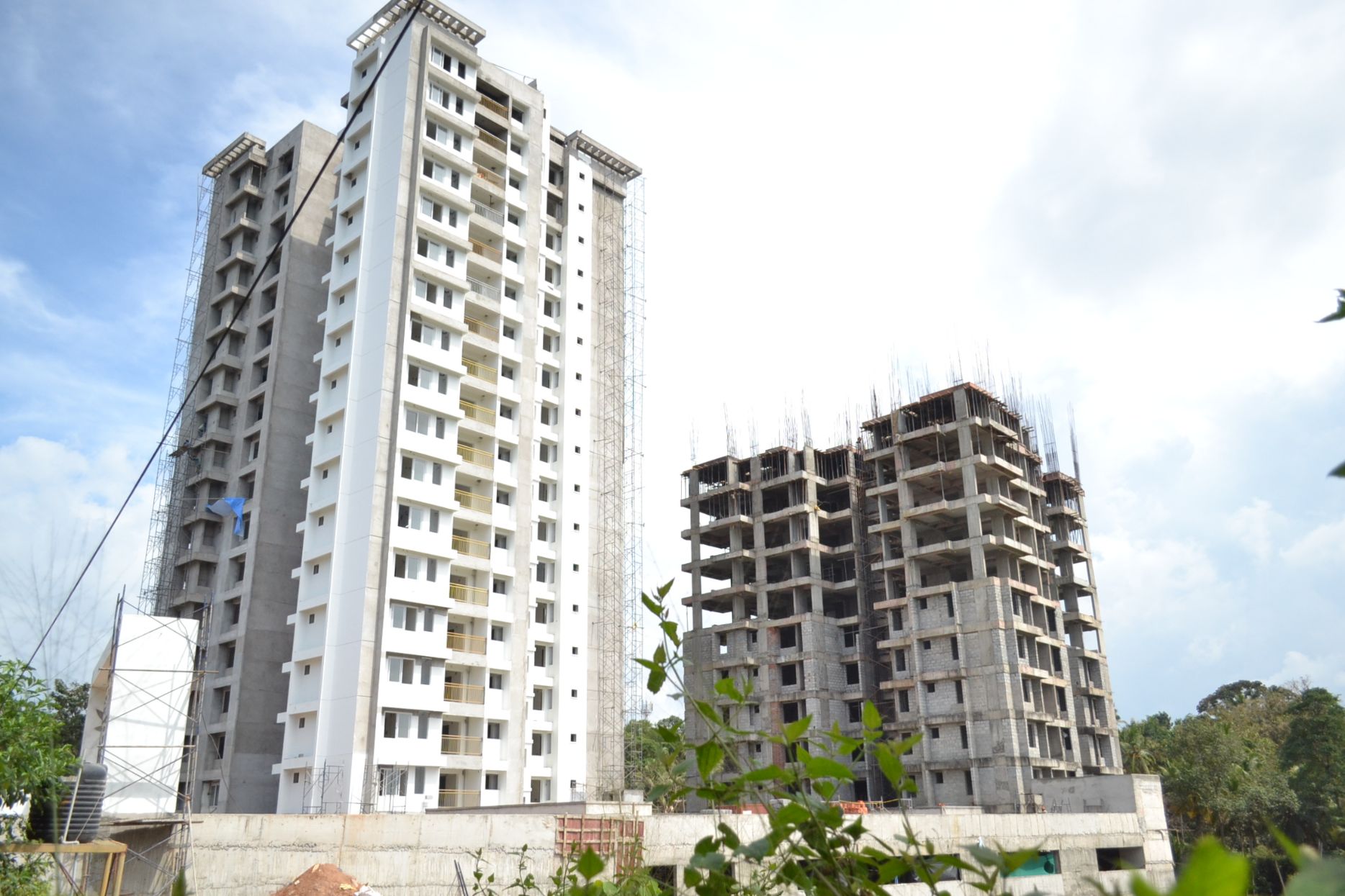

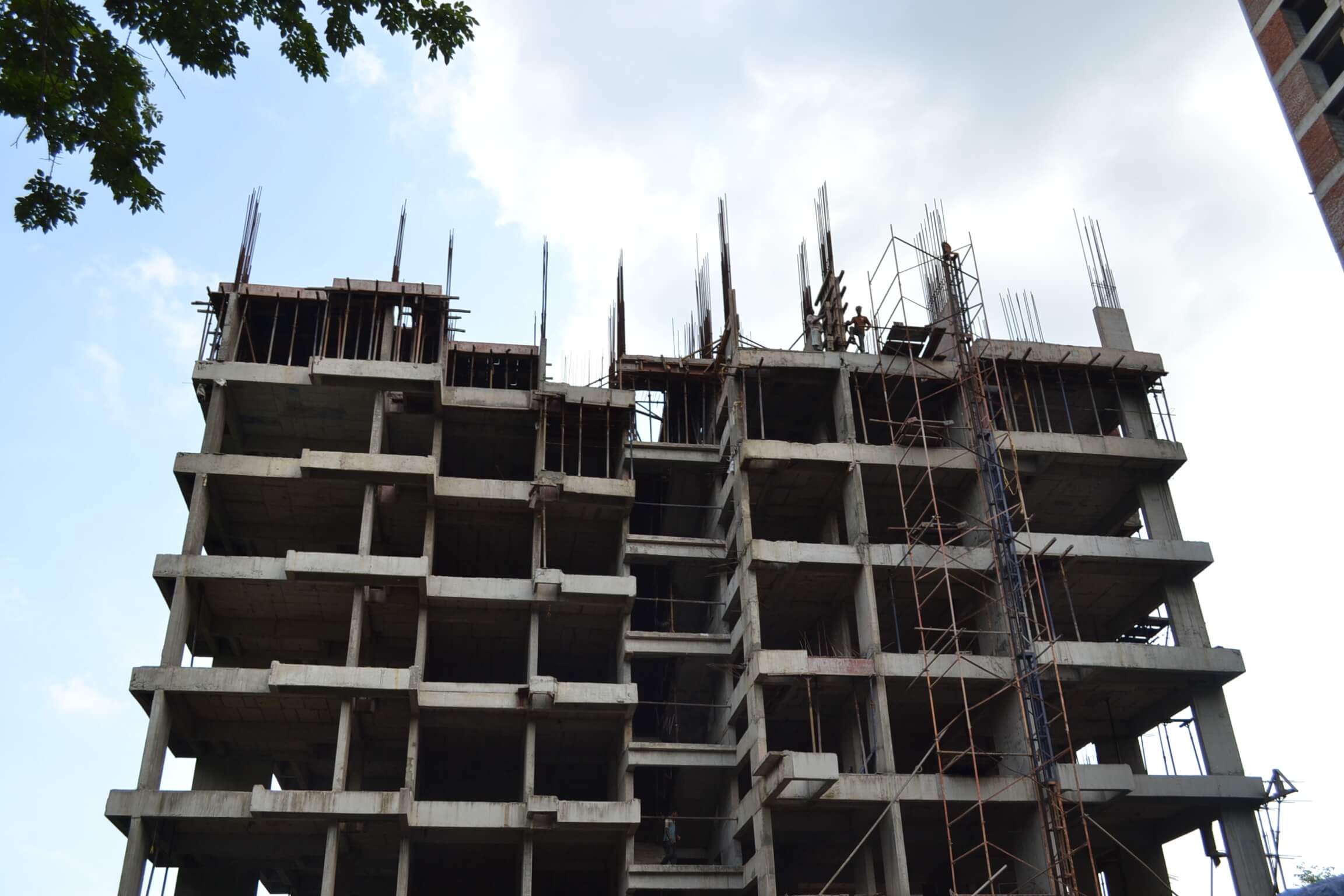

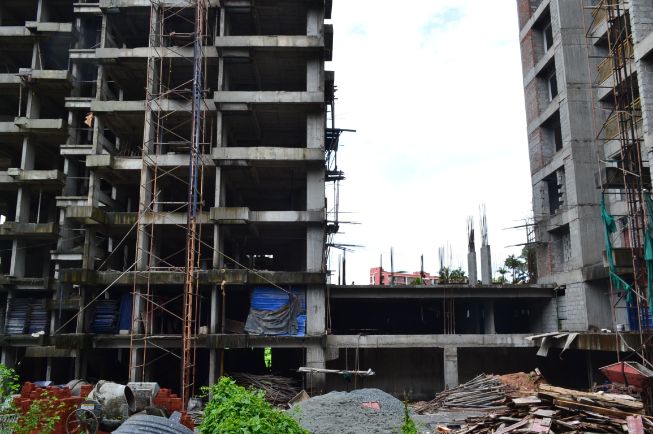

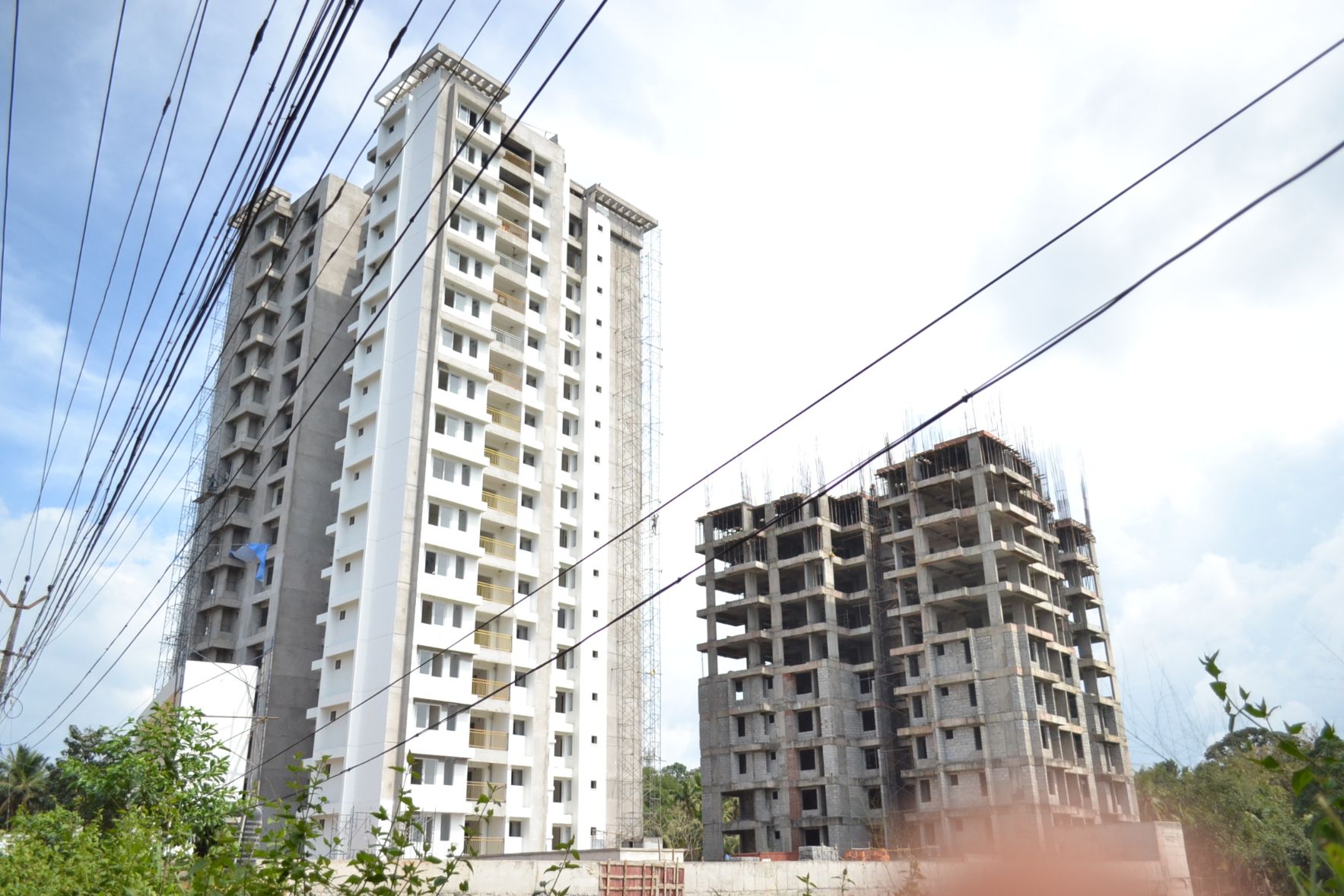

Work status as on 09-07-2022, we have completed the following.

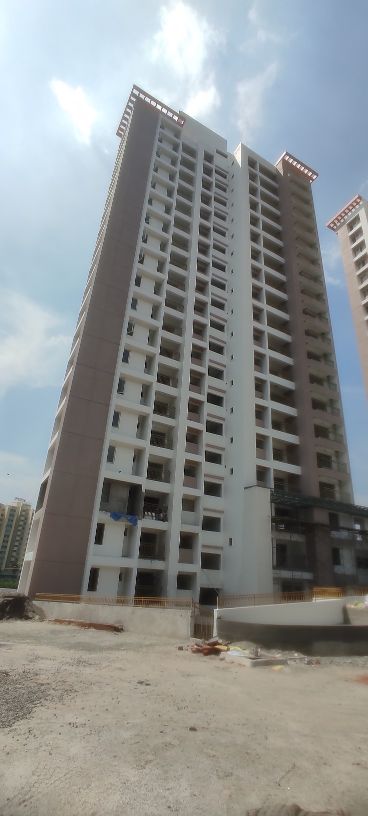

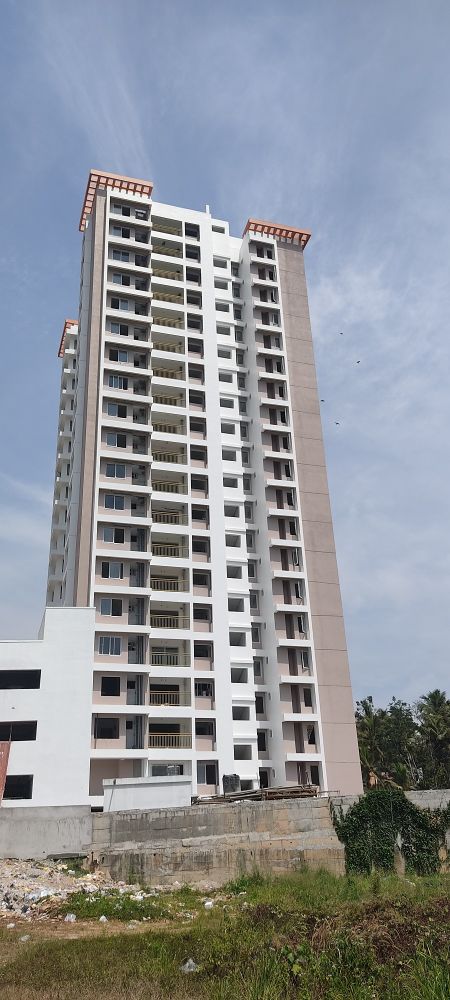

ARTECH METROPOLIS ( TOWER -1 )
- Structural Works – All sub-structural and structural works- completed
- Civil Works – Ceiling plaster – completed, Masonry – completed, Screeding- 1st to Terrace floor completed

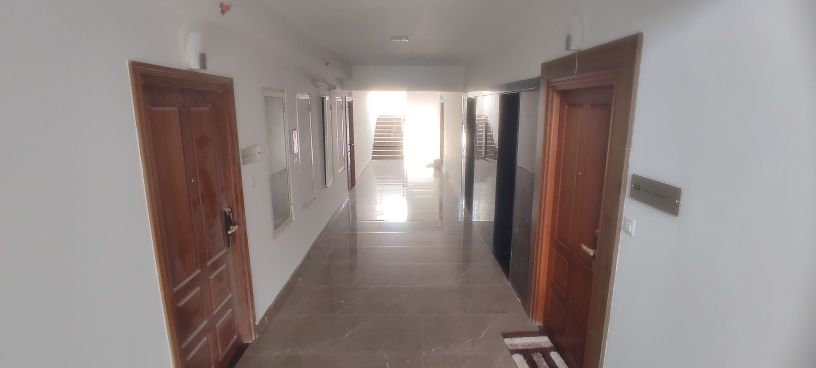

- Internal Finishes – Main door – (GF to 17th floor completed) 74 nos Fixed, Waterproofing- BF -1, BF – 2, G/F to Terrace completed, Wall tiling – BF -1, G/F to 17th floor completed, Flooring – BF – 1, G/F to 17th floor completed (99% completed), BF – 2, 90% completed, BF – 3, 50% completed, Terrace completed, putty works & Painting- 1st Floor to 17th Floor Flat inside 1st and 2nd coat putty and one coat primer completed, 1st Floor to 17th Floor stair and passage 2nd coat putty and one coat primer completed, Door frame fixtures- G/F to 4th Floor completed, Handrails- completed

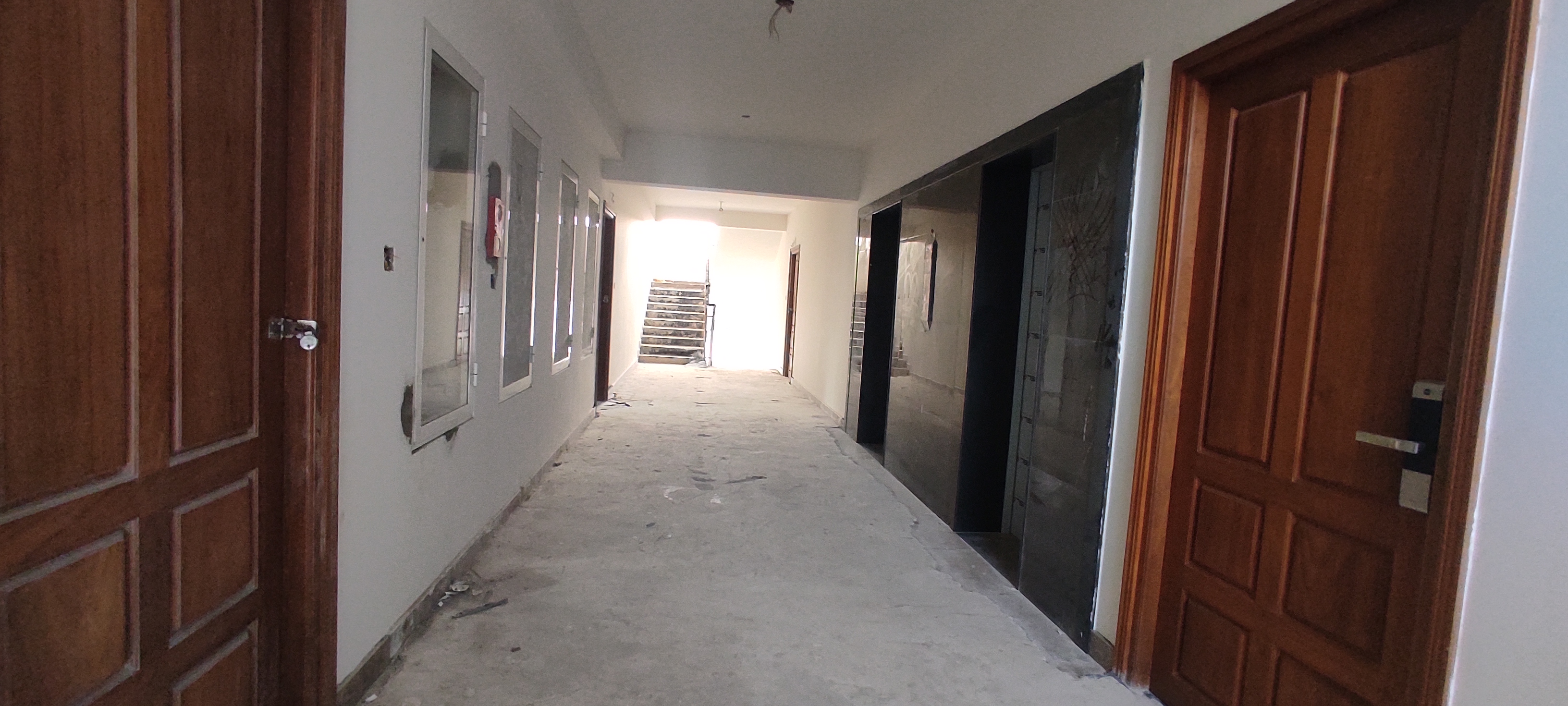

- Electrical, Plumbing & Firefighting works – Concealed plumbing works – G/F to Terrace completed, BF – 1 Completed, BF -2 Completed, Corridor handrail works – completed, Wall and floor services, Risers, – completed, Centralised Gas piping system – 90% completed (GF to 17th floor)
- Final Finishes – Door shutters & ironmongery, – 27 flats completed, Final Painting,-Two coat painting 18 flats completed, Plumbing & Sanitaryware-17 flats completed, Electrical final fixtures,- 20 flats completed, Firefighting final fixtures – GF to 17 th floor completed
- External Finishes – Windows & Sliding doors- 80% completed, External Plastering- completed, External Painting – 1st coat painting 85% completed

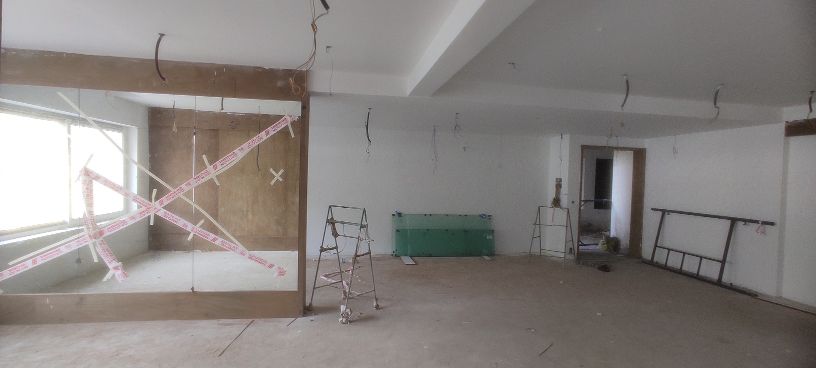

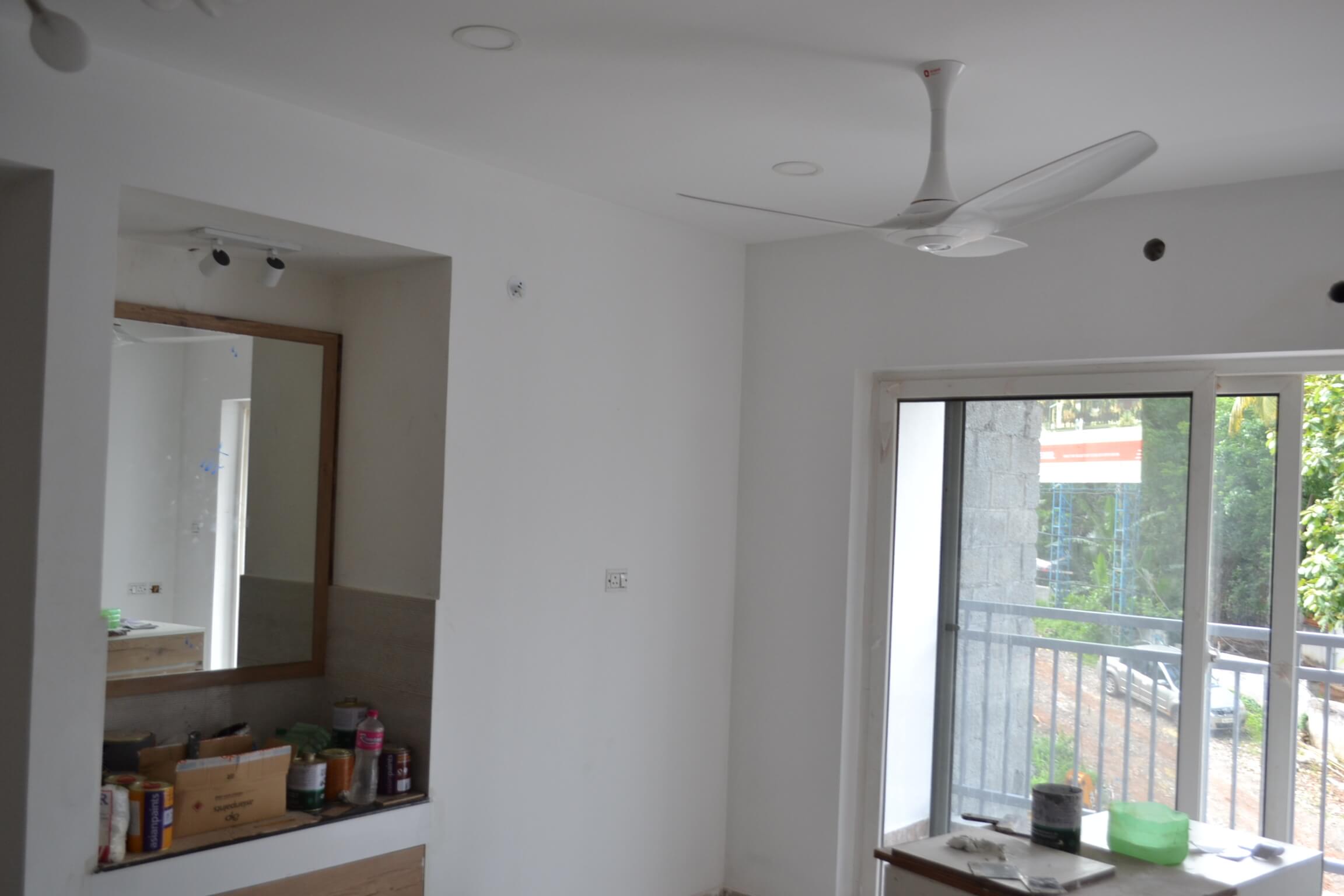

- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – completed, Reticulated gas piping – 100% completed, Painting – 100% completed
ARTECH METROPOLIS (TOWER-2)

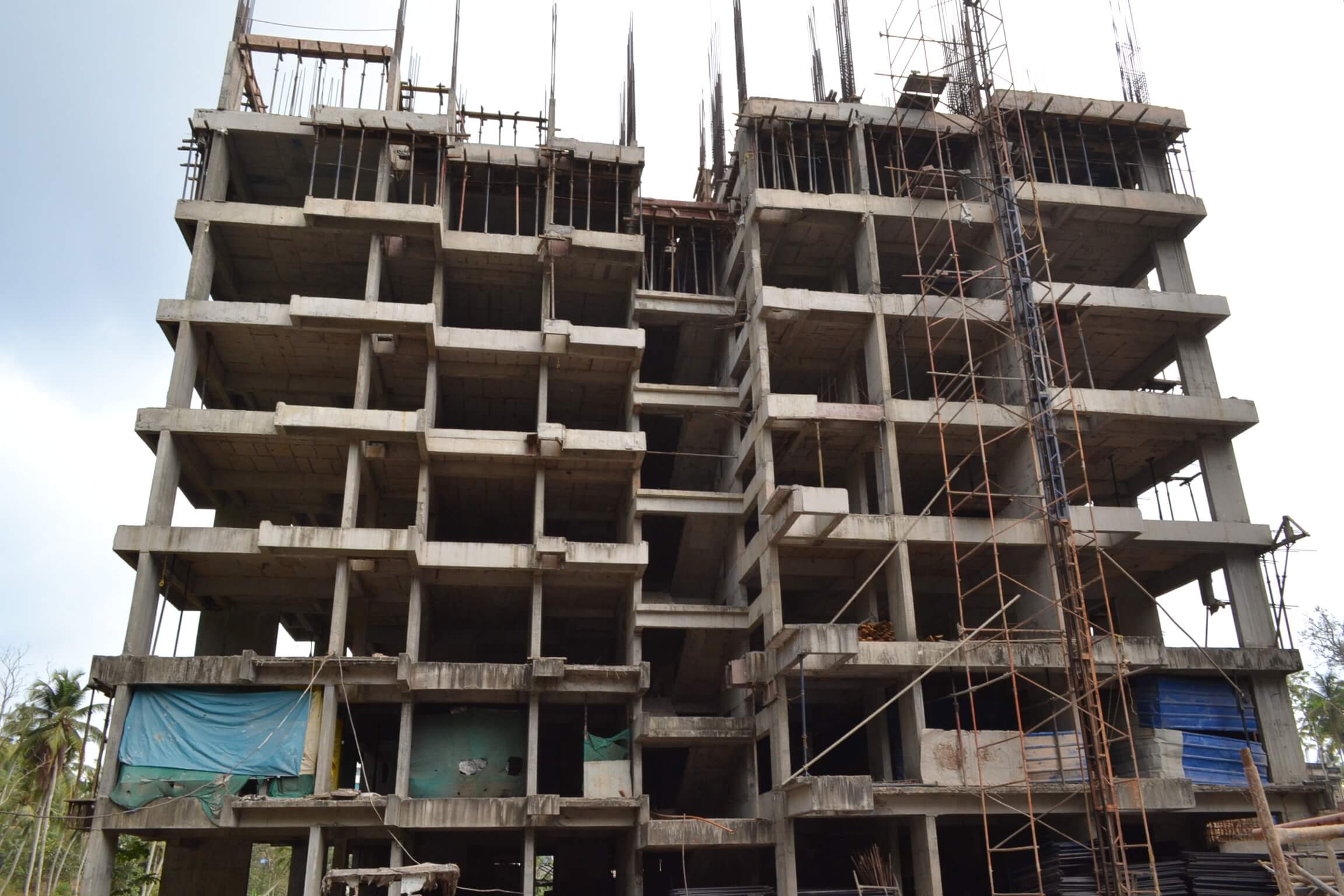

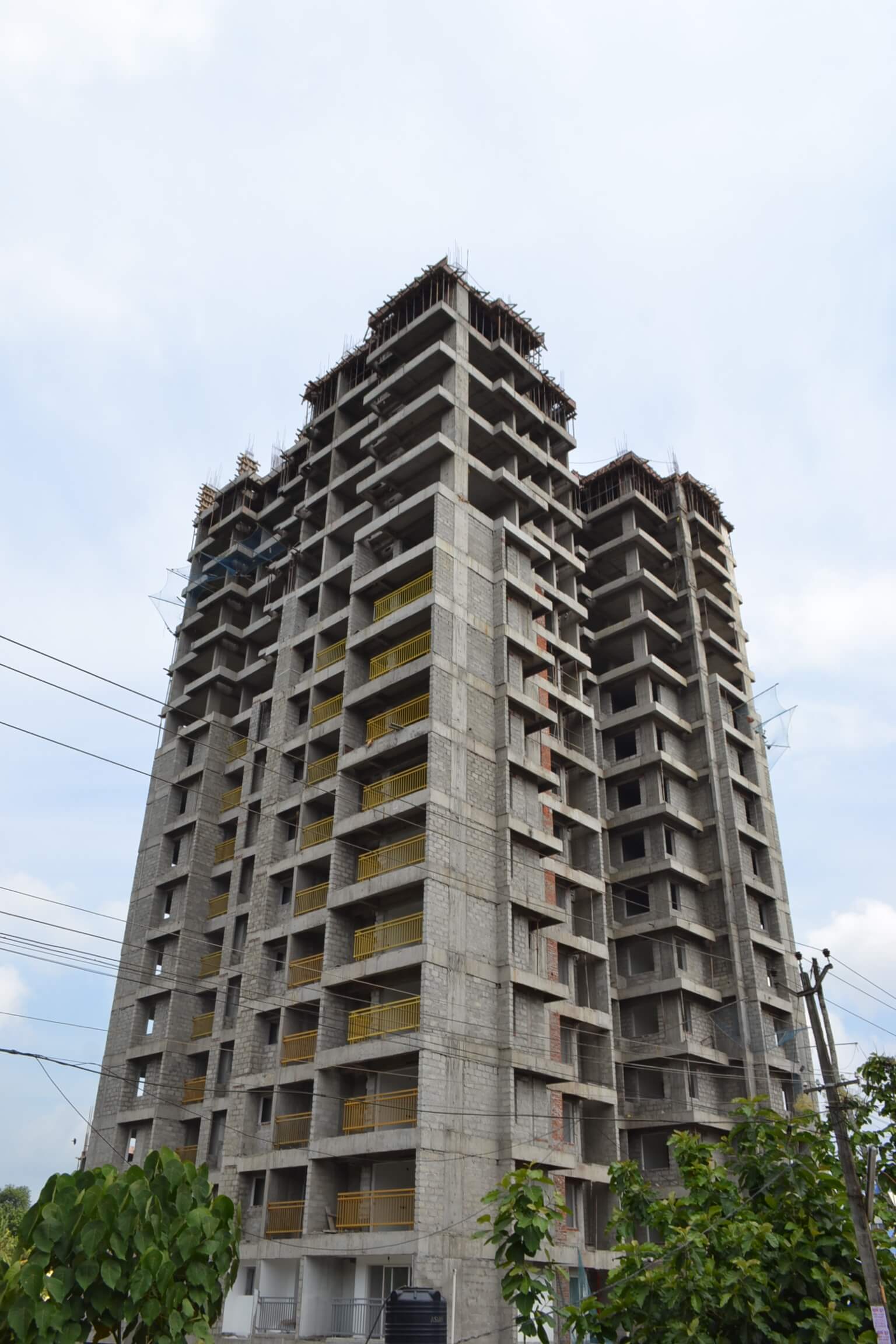

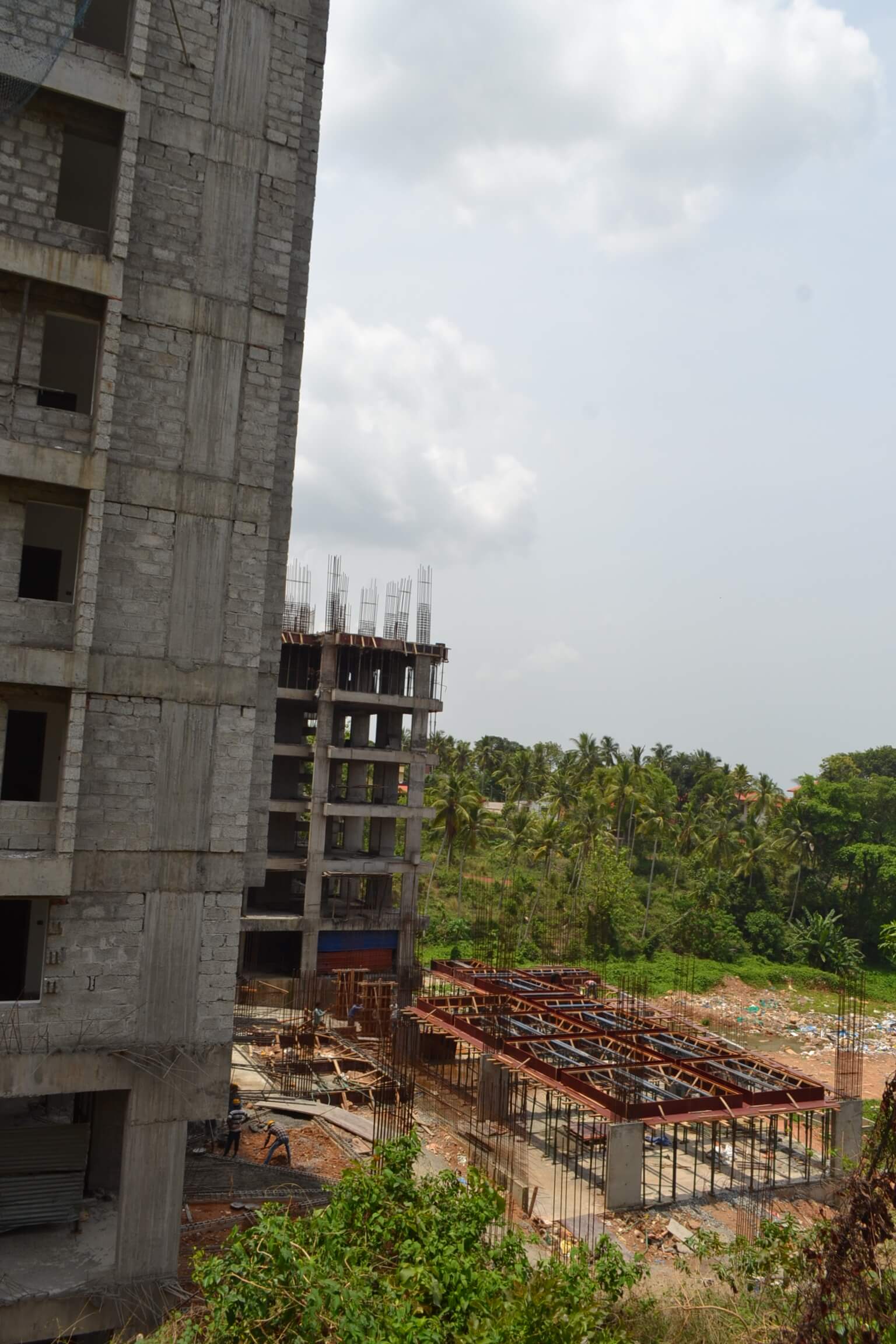

- Structural Works – Pile cap – completed , slab completed -upto terrace Floor completed, All pergola completed, terrace Parapet completed, Lift machine room base completed, stair case head room completed, OH tank base, wall and cover slab completed
- Civil Works – Ceiling plaster completed , wall plastering upto 12th floor completed, 13th, 14th floor – 50% completed, Masonry – Block/ brick completed, 15th – 50% completed.
- Internal Finishes – Waterproofing- 1st to 11th floor completed, putty works & Painting- 3rd to 10th floor 2 coat putty and 2 coat primer completed , Door frame fixtures – Main door frame – 1st to 14th floor completed
- External Finishes – External Plastering, : west side 90 % completed, South side – 50% completed, North side – 75% completed, External painting – west side 2 coat putty 80% completed
As per the current work status from our site, we are targeted to complete the following works by the end of JULY 2022.
ARTECH METROPOLIS ( TOWER -1 )
- Internal Finishes – Main Door – 1 more to be fixed, water Proofing BF – 3, 80% to be completed, Wall tiling – BF -2, 100% to be completed, Flooring – BF – 2, 10% more to be completed, BF – 3, 30% more to be completed, Primer work – BF -1, terrace 100% to be completed
- Electrical, Plumbing & Firefighting works – gas work 100% to be completed.
- Final Finishes – Door shutter fixing – 7 more flats to be completed, painting- two coat painting- 6 more flats to be completed, plumbing & sanitary – 5 more flats to be completed, Eletrical final fittings – 6 more flats to be completed, Fire fighting final fitting – BF-1, BF-2 to be completed
- External Finishes – External painting – 1st coat painting 100% to be completed
ARTECH METROPOLIS (TOWER-2)
- Structural Works – Machine room block work and plastering to be completed
- Civil Works – wall plastering :13th, 14th floor 100% to be completed, block work – 15th floor 50% more to be completed.
- Internal Finishes – water proofing -12th, 13th floor 100 % to be completed , putty works and painting – 11th, 12th floor 2 coat putty and 2 coat primer 100% to be completed, Main door frame -15th ,16th floor 100% to be completed.
- External Finishes – External plastering – south and north side 25% more to be completed, External painting – west side 2 coat putty 20% more to be completed.

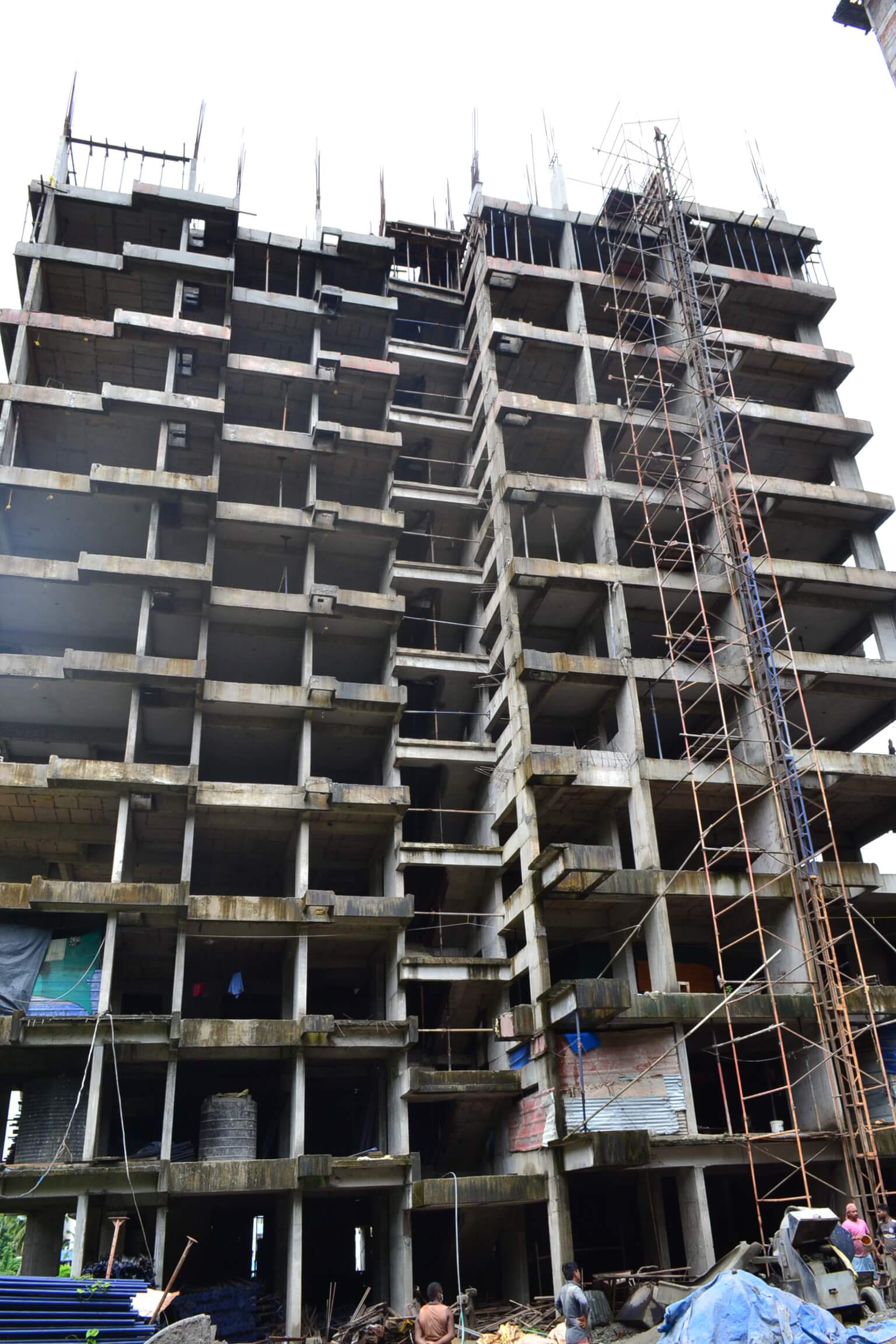

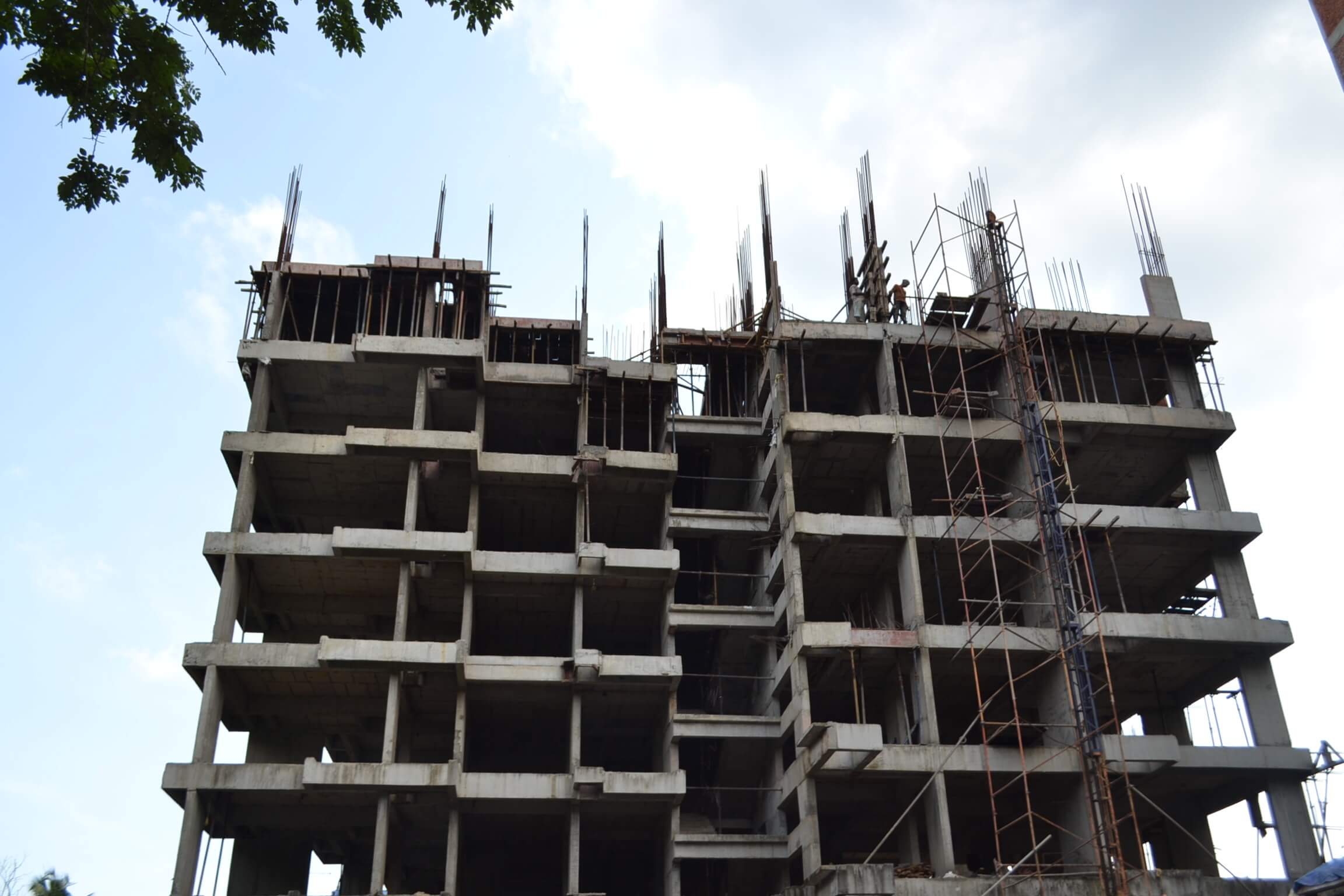

Work status as on 09-06-2022, we have completed the following.
ARTECH METROPOLIS ( TOWER -1 )
- Structural Works – All sub-structural and structural works- completed
- Civil Works – Ceiling plaster – completed, Masonry – completed, Screeding- 1st to Terrace floor completed
- Internal Finishes – Main door – (GF to 17th floor completed) 74 nos Fixed, Waterproofing- BF -1, BF – 2, G/F to Terrace completed, Wall tiling- BF -1, G/F to 17th floor completed, Flooring- BF – 1, G/F to 17th floor completed (99% completed), BF – 2, 90% completed, BF – 3, 50% completed, Terrace completed, putty works & Painting- 1st Floor to 17th Floor Flat inside 1st and 2nd coat putty and one coat primer completed, 1st Floor to 17th Floor stair and passage 2nd coat putty and one coat primer completed, Door frame fixtures- G/F to 4th Floor completed, Handrails- completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – G/F to Terrace completed, BF – 1 Completed, BF -2 Completed, Corridor handrail works – completed, Wall and floor services, Risers, – completed, Centralised Gas piping system – 85% completed (GF to 17th floor)
- Final Finishes – Door shutters & ironmongery, – 21 flats completed, Final Painting,-Two coat painting 15 flats completed, Plumbing & Sanitaryware-12 flats completed, Electrical final fixtures,- 17 flats completed, Firefighting final fixtures – GF to 17 th floor completed
- External Finishes – Windows & Sliding doors,- 75% completed, External Plastering,- completed, External Painting, – 1st coat painting 80% completed
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – completed, Reticulated gas piping – 100% completed, Painting – 100% completed
ARTECH METROPOLIS (TOWER-2)

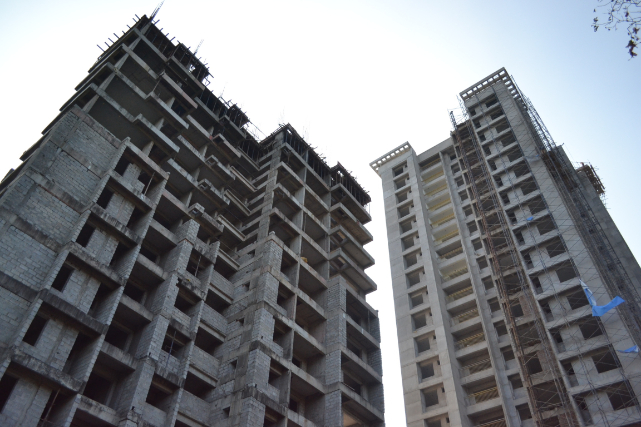

- Structural Works – Pile cap – completed , slab completed -upto terrace Floor completed, E, F”, H flat pergola completed, terrace Parapet completed, Lift machine room base completed, stair case head room completed, OH tank base, wall and cover slab completed
- Civil Works – Ceiling plaster completed , wall plastering upto 12th floor completed, Masonry – Block/ brick completed, 15th – 50% completed.
- Internal Finishes – Waterproofing- 3rd to 10th floor completed, putty works & Painting- up to 8th floor 2 coat putty and 2 coat primer completed , Door frame fixtures – Main door frame – 1st to 14th floor completed
- External Finishes – External Plastering, : west side 90 % completed, South side – 50% completed, North side – 50% completed, External painting – west side 2 coat putty 50% completed
As per the current work status from our site, we are targeted to complete the following works by the end of JUNE 2022.
ARTECH METROPOLIS ( TOWER -1 )
- Internal Finishes – Main Door – 1 more to be fixed, water Proofing BF – 3, 80% to be completed, Wall tiling – BF -2, 100% to be completed, Flooring – BF – 2, 10% more to be completed, BF – 3, 30% more to be completed, Primer work – BF -1, terrace 100% to be completed
- Electrical, Plumbing & Firefighting works – gas work 100% to be completed.
- Final Finishes – Door shutter fixing – 10 more flats to be completed, painting- two coat painting- 8 more flats to be completed, plumbing & sanitary – 5 more flats to be completed, Eletrical final fittings – 6 more flats to be completed, Fire fighting final fitting – BF-1, BF-2 to be completed
- External Finishes – External painting – 1st coat painting 100% to be completed
ARTECH METROPOLIS (TOWER-2)
- Structural Works – Machine room block work and plastering to be completed
- Civil Works – wall plastering :13th, 14th floor 100% to be completed.
- Internal Finishes – water proofing 11th, 12th, 13th floor 100 % to be completed , putty works and painting – 9th and 10th floor 2 coat putty and 2 coat primer 100% to be completed
- External Finishes – External plastering – south and north side 50% more to be completed, External painting – west side 2 coat putty 50% more to be completed

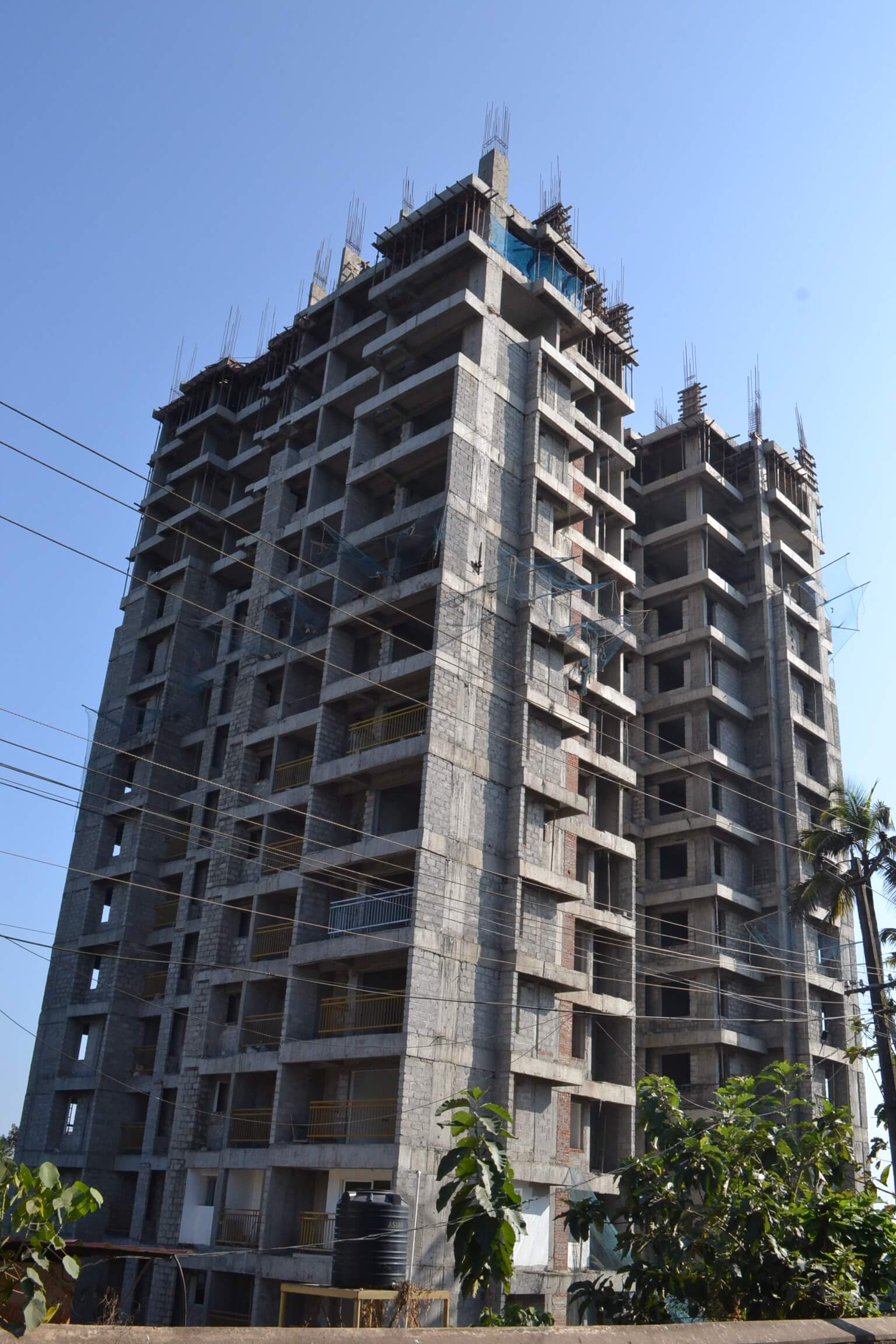

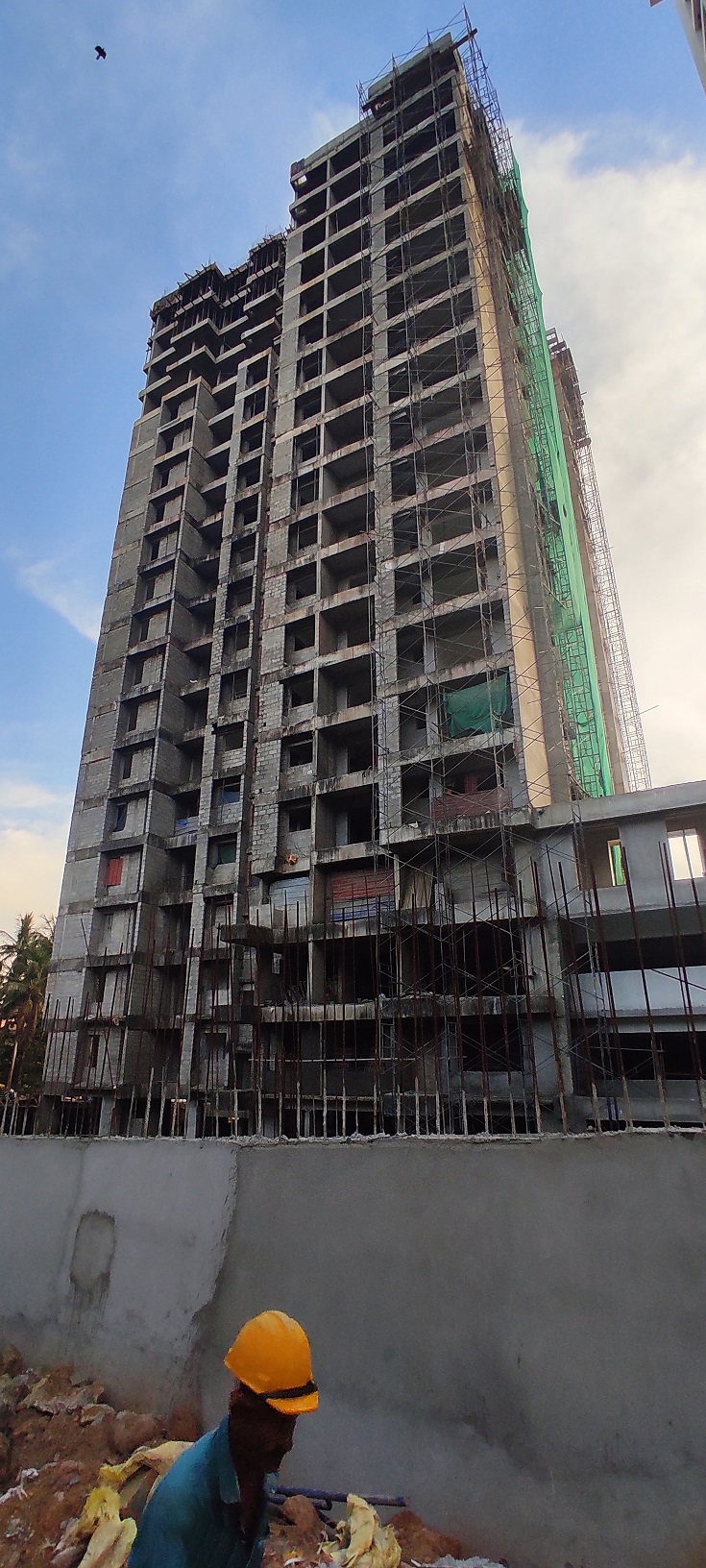

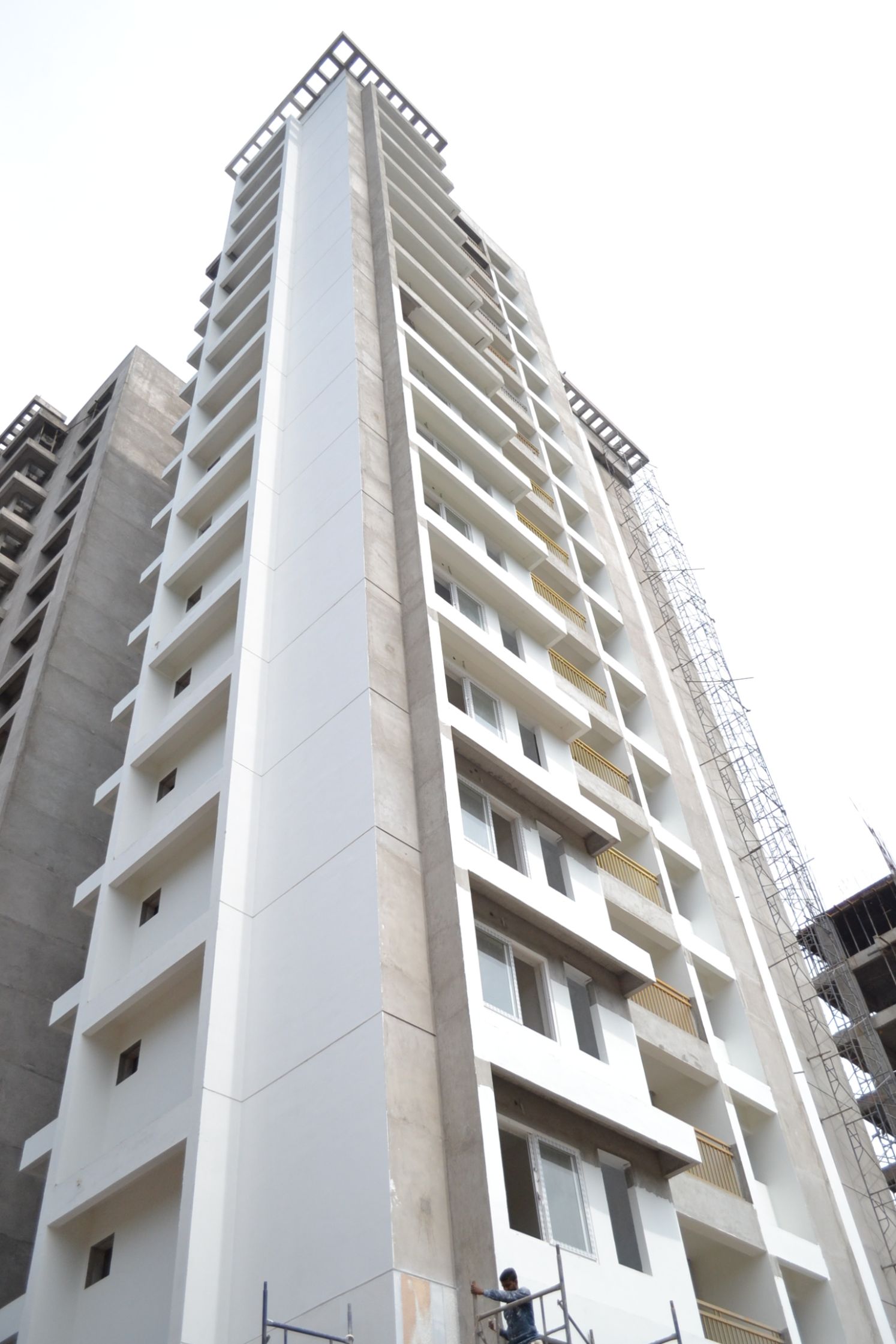

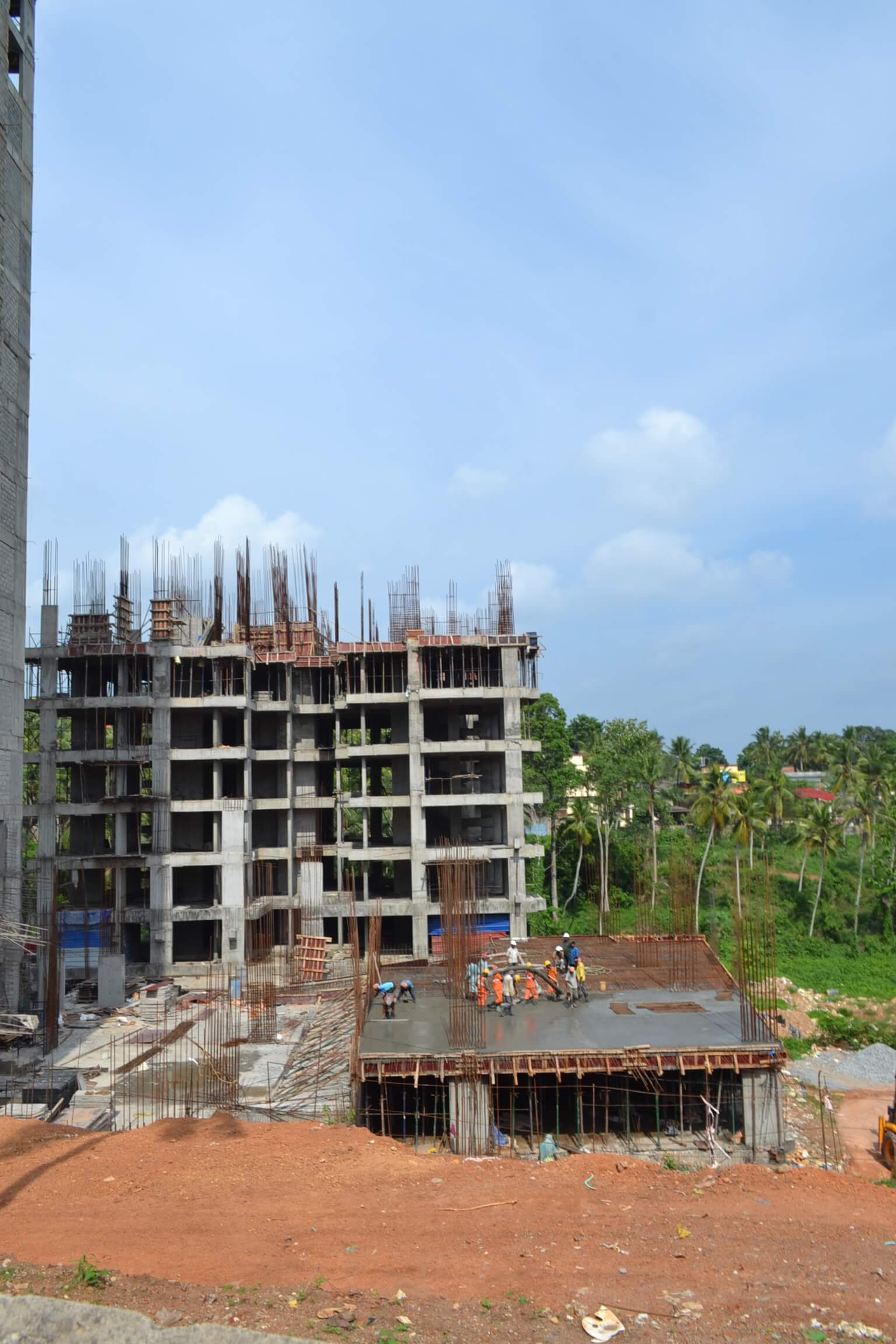

Work status as on 13-04-2022, we have completed the following.
TOWER -1
- Structural Works – All sub-structural and structural works- completed
- Civil Works – Ceiling plaster – completed, Masonry – completed, Screeding- 1st to Terrace floor completed
- Internal Finishes – Main door – (GF to 17th floor completed) 71 nos Fixed, Waterproofing- BF -1, G/F to Terrace completed, Wall tiling- BF -1, G/F to 17th floor completed, Flooring- BF – 1, G/F to 17th floor completed (99% completed),Terrace completed, putty works & Painting- 1st Floor to 17th Floor Flat inside 1st and 2nd coat putty and one coat primer completed, 1st Floor to 17th Floor stair and passage 2nd coat putty and one coat primer completed, Door frame fixtures- G/F to 4th Floor completed, Handrails- completed.
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – G/F to Terrace completed, BF – 1 Completed, Corridor handrail works – completed, Wall and floor services, Risers, – completed, Centralised Gas piping system – 80% completed (GF to 17th floor)
- Final Finishes – Door shutters & ironmongery, -8 flats completed, Final Painting,-Two coat painting 5 flat completed, Plumbing & Sanitaryware-5 flat completed, Electrical final fixtures,- 7 flat completed, Firefighting final fixtures – GF to 17 th floor completed
- External Finishes – Windows & Sliding doors,- 65% completed, External Plastering,- completed, External Painting, – 1st coat painting 80% completed
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – completed, Reticulated gas piping – 100% completed, Painting – 100% completed
TOWER-2

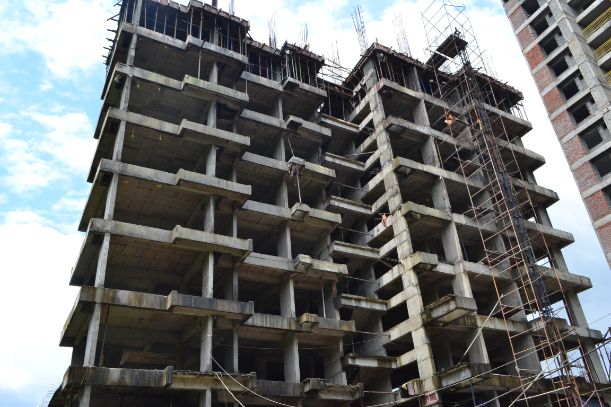

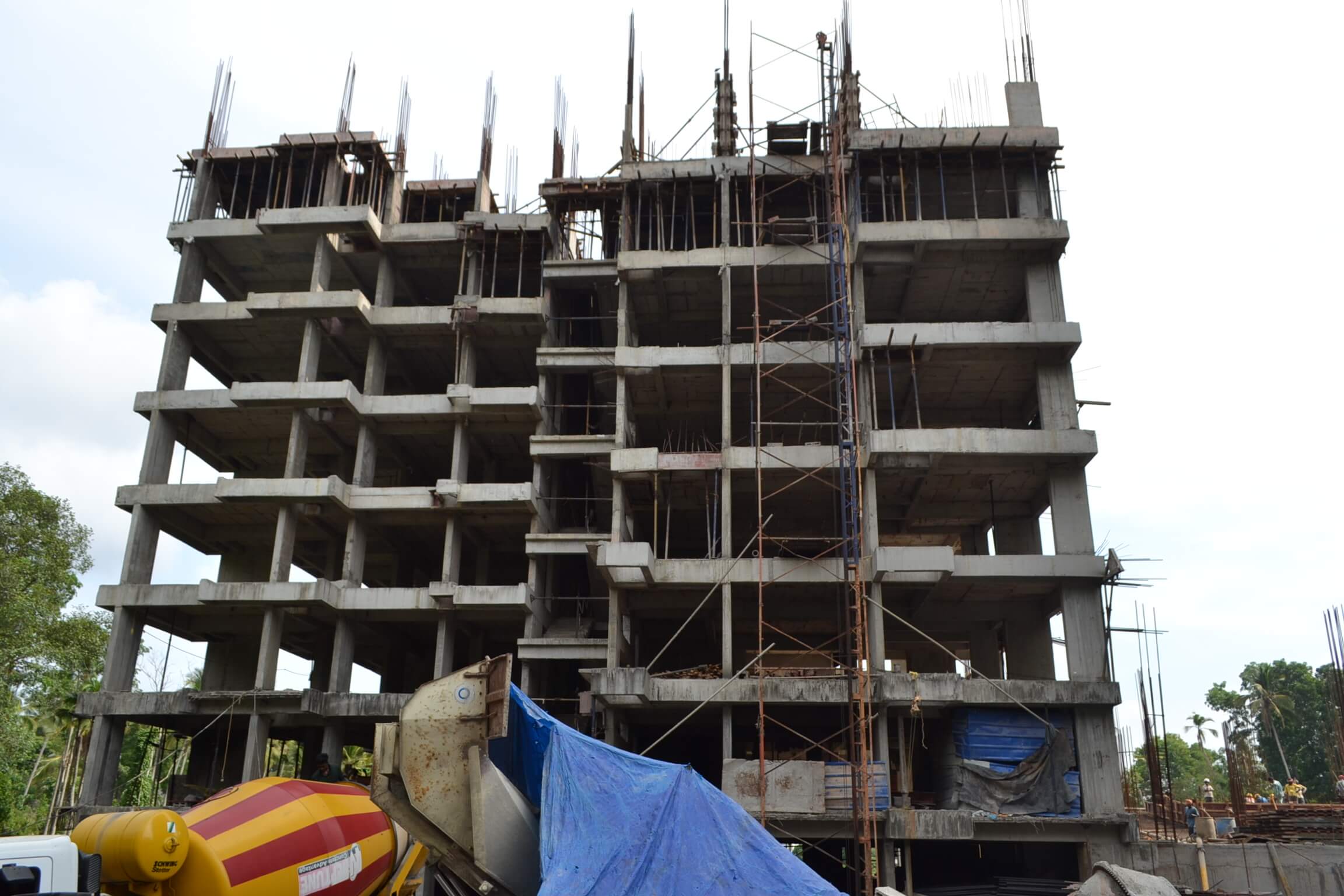

- Structural Works – Pile cap – completed , slab completed -upto terrace Floor completed, E, F” flat pergola completed,terrace Parapet completed, Lift machine room base completed, stair case head room completed.
- Civil Works – Ceiling plaster upto 15th floor completed , wall plastering upto 8th floor completed, 9th floor – 50% completed & 10th floor completed, Masonry – Block/ brick-upto 12th floor completed, 13th – 90% completed,14th,15th16th, floors 20% completed
- Internal Finishes – Waterproofing-2nd and 3rd floor 50% completed, putty works & Painting- 1st coat putty up to 7th floor completed, 8th floor – 2 coat putty work completed.
- External Finishes – External Plastering, : west side 70 % completed
As per the current work status from our site, we are targeted to complete the following works by the end of APRIL 2022.
TOWER -1
- Internal Finishes – Main Door – (BF-1, BF -2 flats remaining) 5 more numbers to be completed, water Proofing BF – 2 80% to be completed, Tiling – BF – 2 80% to be completed, and B/F-1 and terrace primer work to be completed.
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – BF – 2 100% to be completed, gas work 100% to be completed.
- Final Finishes – Door shutter fixing -3 more flats to be completed, painting- two-coat painting- 3 more flats to be completed, plumbing & sanitary -3 more flats to be completed, Electrical final fittings -3 more flats to be completed, Fire fighting final fitting – BF-1, BF-2 more to be completed
- External Finishes – External painting – 100% to be completed
TOWER-2
- Structural Works – Pergola on G” Flat and water tank works to be completed
- Civil Works – Ceiling plastering 16th floor 100% to be completed, wall plastering:9th floor 100% to be completed, blockwork: 13th floor, 14th floor 100% to be completed.
- Internal Finishes – waterproofing balance 50 % to be completed,
- External Finishes – Front side near E& F flat balance to be completed.

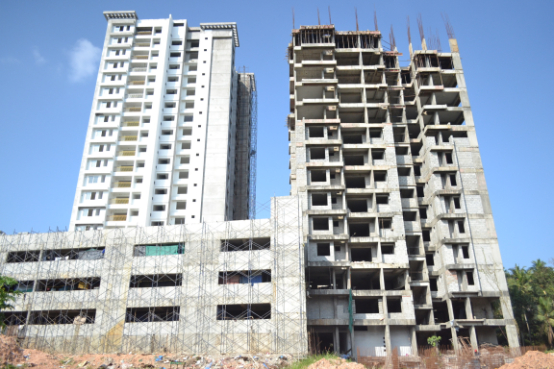

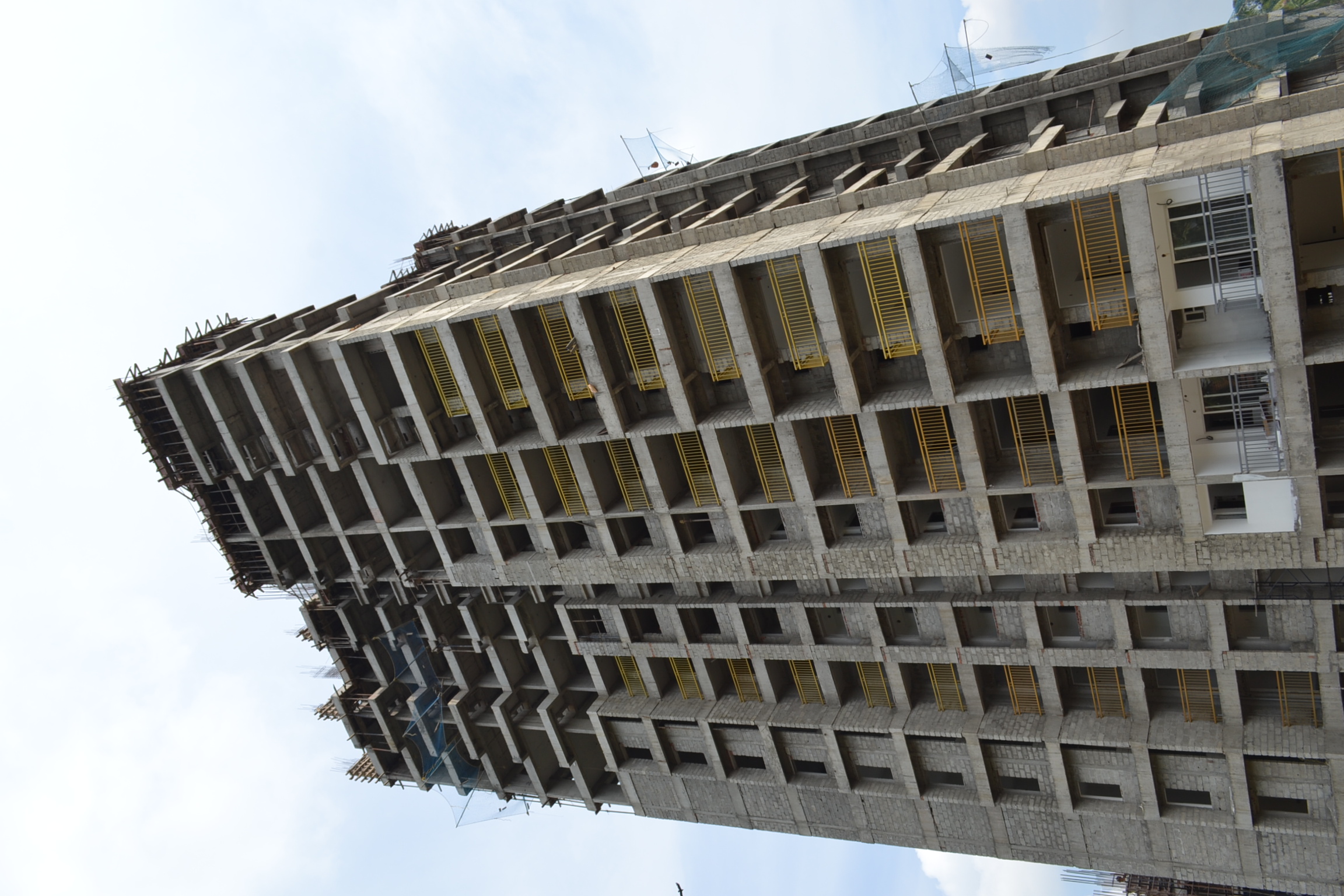

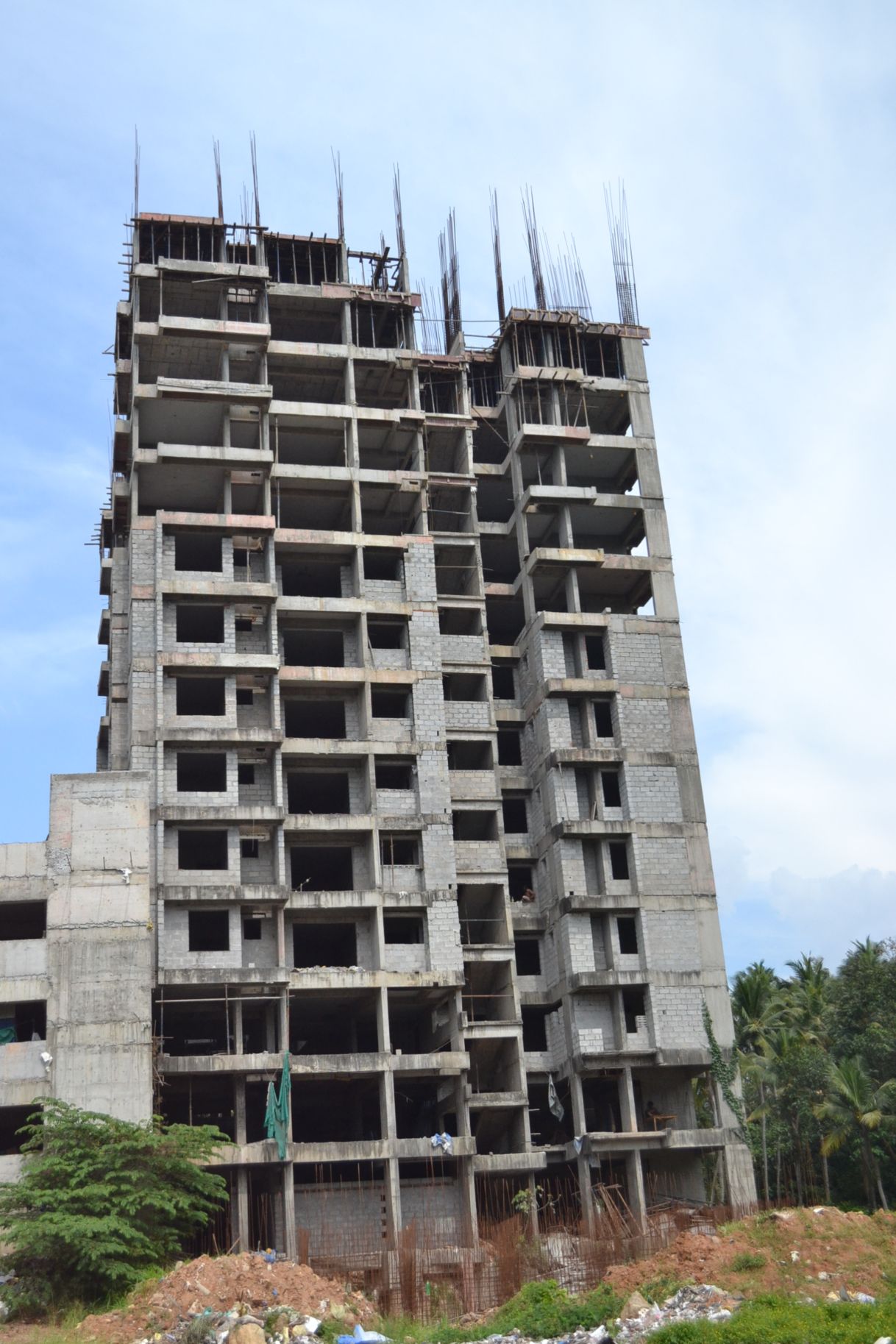

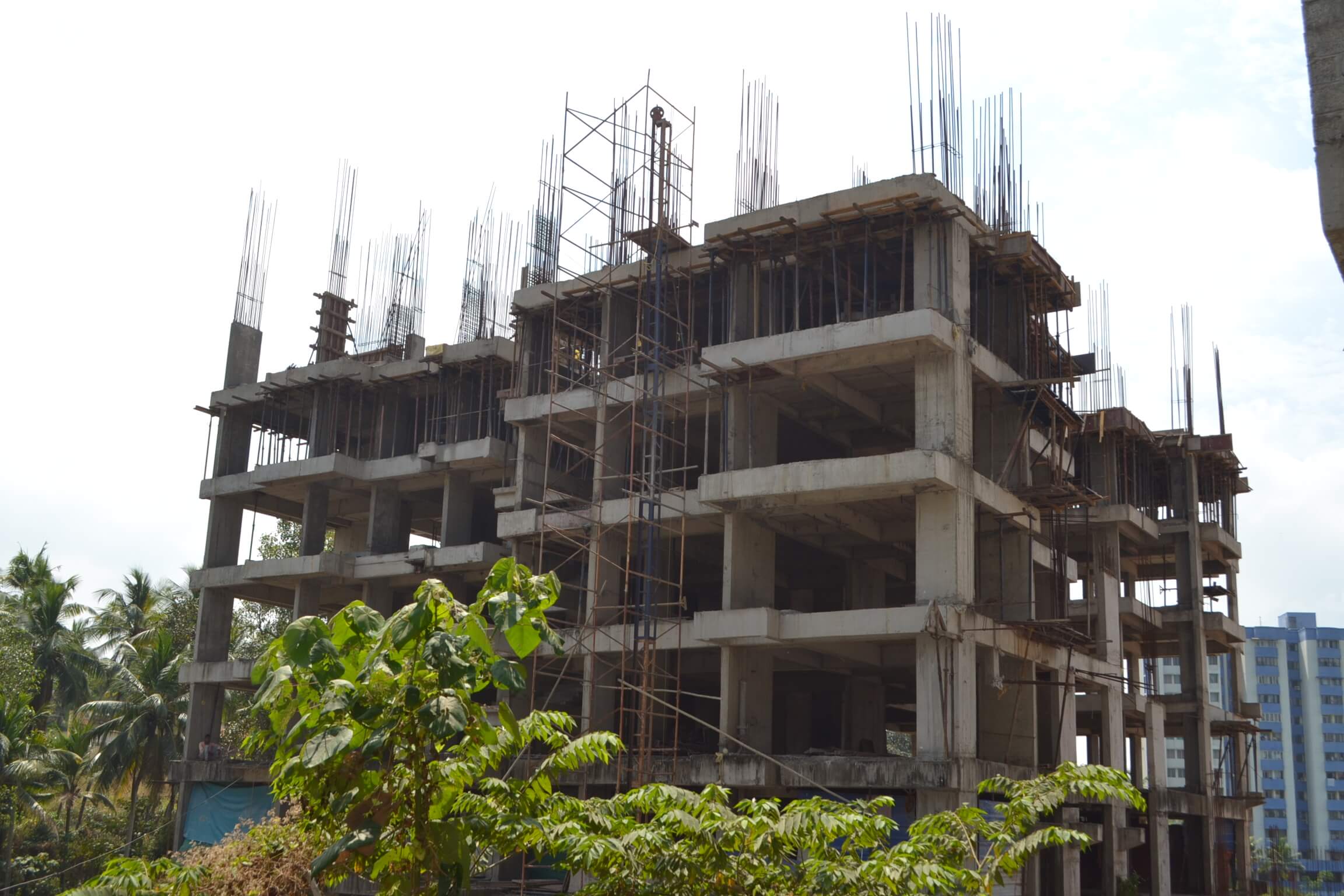

Work status as on 10-03-2022, we have completed the following.
TOWER -1
- Structural Works – All sub-structural and structural works- completed
- Civil Works – ceiling plaster – completed, Masonry – completed, Screeding- 1st to Terrace floor completed
- Internal Finishes – Main door – 71 nos Fixed, Waterproofing- G/F to Terrace completed, BF -1 completed.Wall tiling- G/F to 17th floor, BF-1 completed, Flooring- G/F to 17th floor completed (99% completed),Terrace completed BF – 1 Completed, putty works & Painting- 1st Floor to 17th Floor Flat inside 1st and 2nd coat putty and one coat primer completed, 1st Floor to 17th Floor stair and passage 2nd coat putty and one coat primer completed, Door frame fixtures- G/F to 4th Floor completed, Handrails- completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing works- G/F to Terrace completed, BF – 1 Completed, Corridor handrail works – completed, Wall and floor services, Risers, – completed, Centralised Gas piping system – 75% completed
- Final Finishes – Door shutters & ironmongery, -8 flats completed, Final Painting,-Two coat painting 5 flat completed, Plumbing & Sanitaryware-5 flat completed, Electrical final fixtures,- 7 flat completed, Firefighting final fixtures – 5 flat completed
- External Finishes – Windows & Sliding doors,- 65% completed, External Plastering,- completed, External Painting, – 1st coat painting 80% completed
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – 100% completed
TOWER-2
- Structural Works – Pile cap – completed , slab completed -upto terrace Floor completed, F” flat pergola completed,terrace Parapet 80% completed.
- Civil Works – ceiling plaster upto 13th floor completed , wall plastering upto 8th floor completed & 10th floor completed, Masonry – Block/ brick-upto 12th floor completed, 5,13th,14th,15th16th, floors 20% completed
- Internal Finishes – Waterproofing-2nd and 3rd floor 50% completed, putty works & Painting- 1st coat putty 2nd,3rd,4th,6th floor completed,5th floor one coat primer completed.
- External Finishes – External Plastering, : west side below 10th floor 100 % completed
As per the current work status from our site, we are targeted to complete the following works by the end of MARCH 2022.
TOWER -1
- Internal Finishes – Main Door -5 more noumbers to be completed, water Proofing BF -2 80% to be completed, Tiling ,BF- 2 70% to be completed. and B/F-1 and terrace primer work to be completed.
- Electrical, Plumbing & Firefighting works – gas work 85% to be completed.
- Final Finishes – Door shutter fixing -3 more flats to be completed, painting- two coat painting- 3 more flats to be completed, plumbing & sanitary -3 more flats to be completed, Eletrical final fittings -3 more flats to be completed, Fire fighting final fitting – 3 more flats to be completed
- External Finishes – External painting – 100% to be completed
TOWER-2
- Structural Works – Terrace Parapet balance and pergola on E” FLAT and lift room base ,terrace floor stair room slab to be completed
- Civil Works – wall plastering :9th floor to be completed, block work : 13th floor to be completed,14th floor celing plastering to be completed.
- Internal Finishes – water proofing balance 80 % to be completed
- External Finishes – front side near E& F flat balance to be completed.
As per the current work status from our site we are targeted to complete the following works by end of February 2021
Tower 1
- Internal wall plastering work -Roof-100% to be completed.
- Outside Plastering:- 100% to be completed.
- Dadoing of toilets:16th floor -100% to be completed
- Dadoing of kitchen walls:14th floor-100% to be completed,
- 16th floor -100% to be completed,
- Water Proofing work -floor, terrace -100% to be completed
- Internal Primer -second coat:-16th floor :-100% to be completed.
- External Painting -(1st coat) :-at south -100% to be completed, at west- 100% to be completed
- External Primer -(first coat) :- at south -100% to be completed, at west- 75% to be completed.
- Outside Putty work -40% to be completed
- Plumbing work -17th floor-100% to be completed.
- Flooring and skirting :-,14th floor- 100% to be completed, 15th floor:- 50% to be completed
- 13th-15th floor- 100% to be completed.
- Aluminium windows & ventilators-GF,18th floor(B)-100% to be completed.
Tower 2

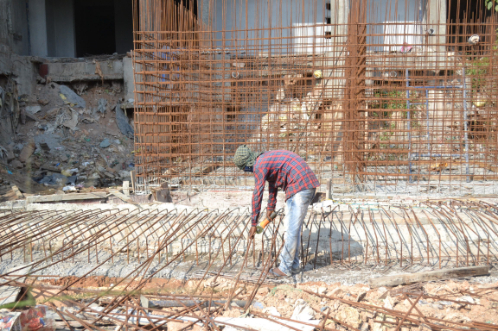

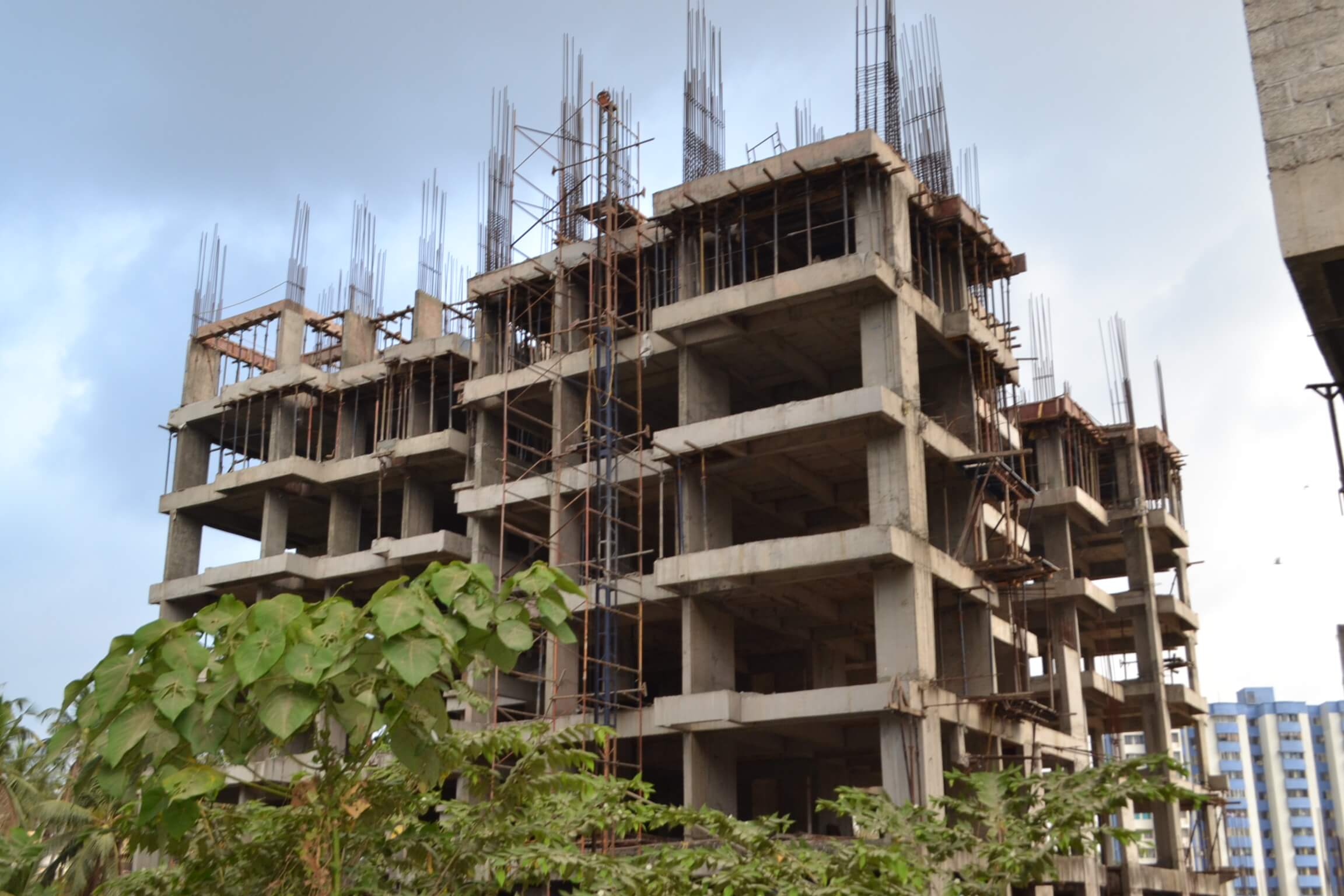

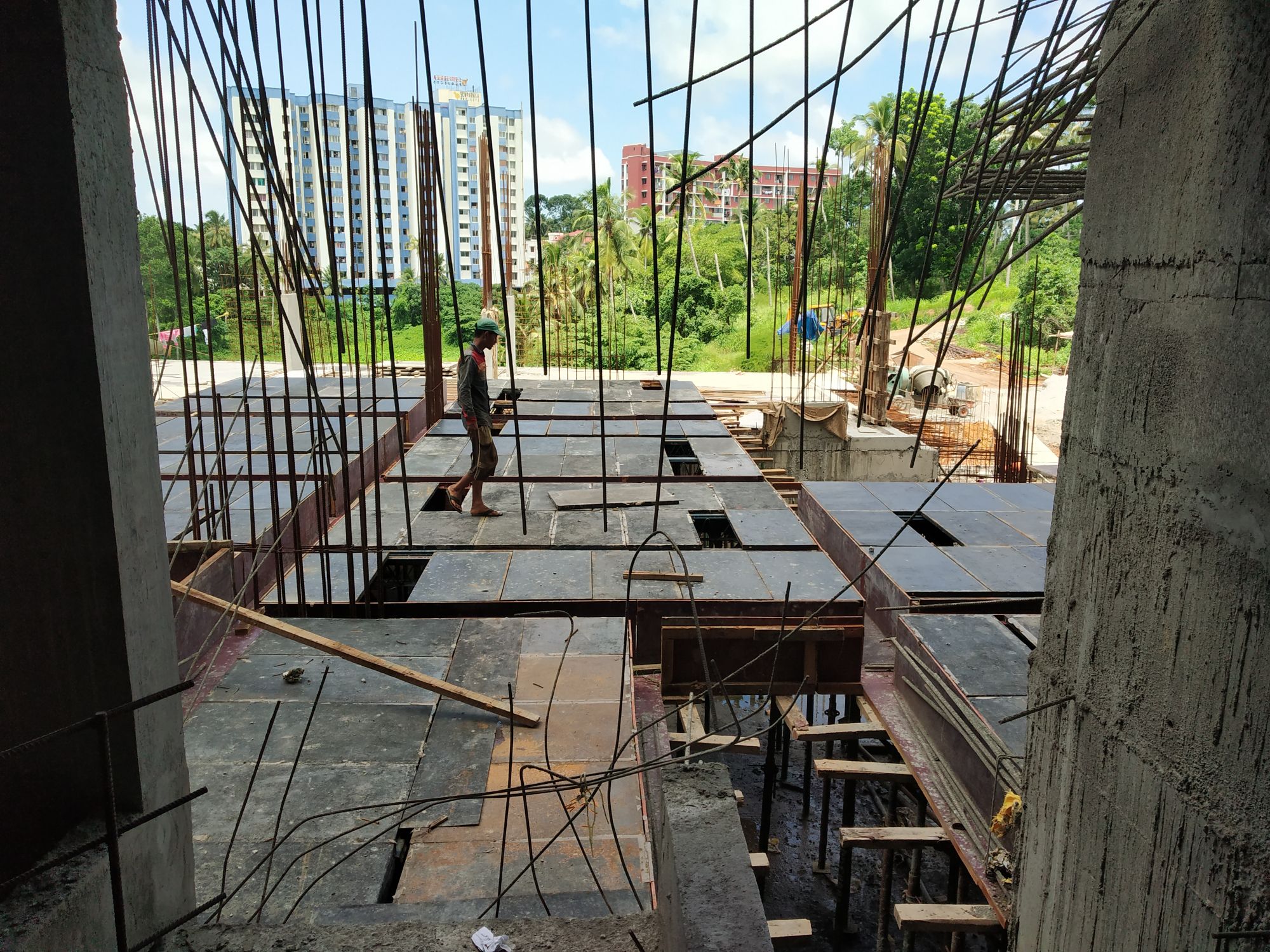

- RCC for slab -11th roof slab -100% to be completed.,12th-30% to be completed.
- Ceiling plastering: 8th -9th floor,BF3 -100% to be completed
- Electrical Wall Chasing: 3rd-4th floor:-100% to be completed.
- Wall Plastering: GF:-100% to be completed, 2nd floor:-100% to be completed.
- Block Work: Basement floor:-100% to be completed, 5th & 6th floor -100% to be completed.

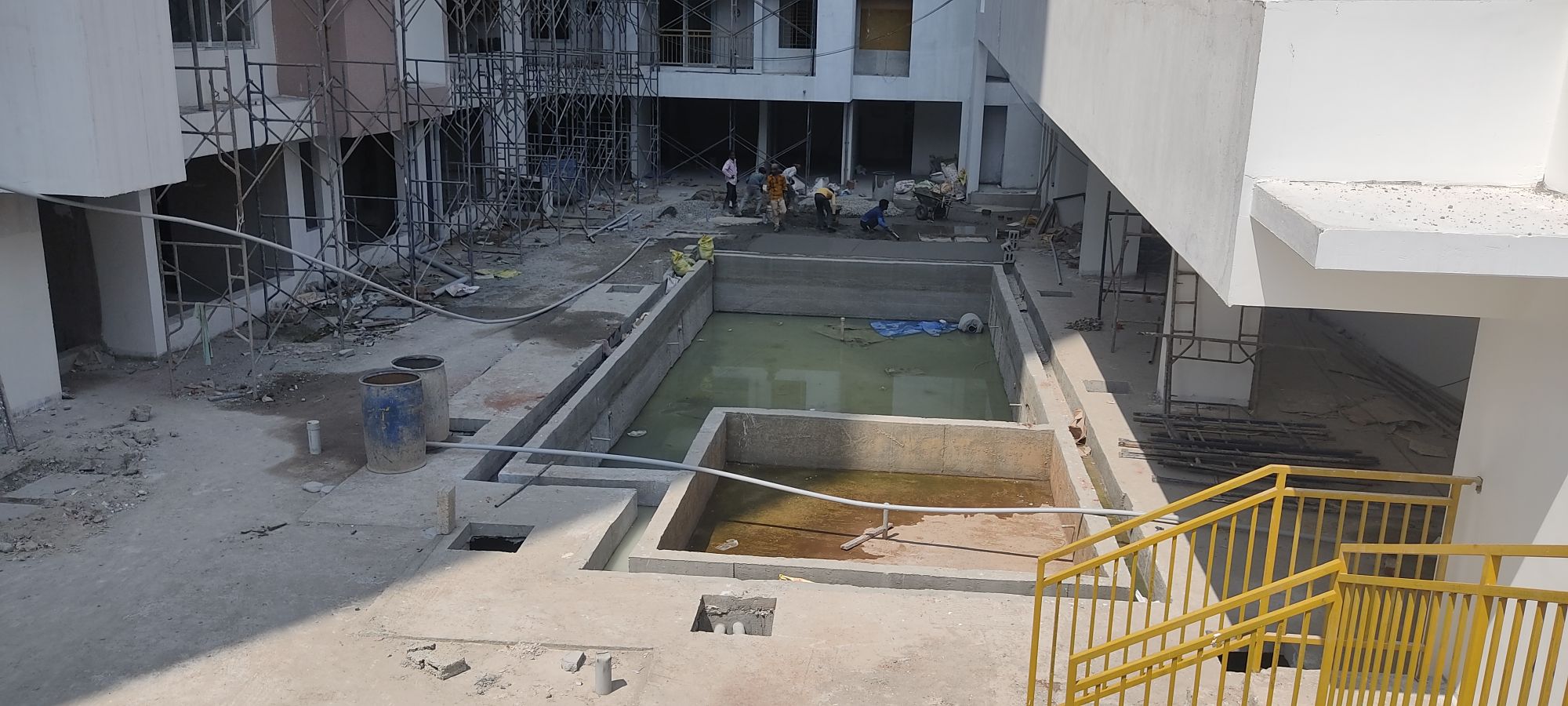

- Yard work: full side retaining wall-40% to be completed, STP RCC -75% to be completed.

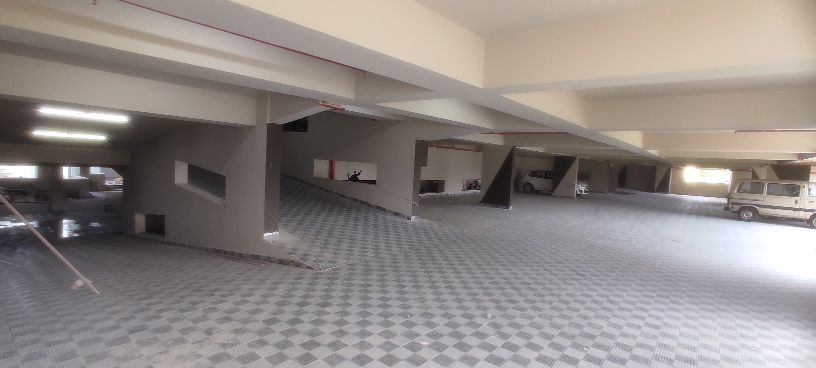

- MLCP: BF2 ceiling & column plastering -100% to be completed, BF3 ceiling & column plastering -100% to be completed.

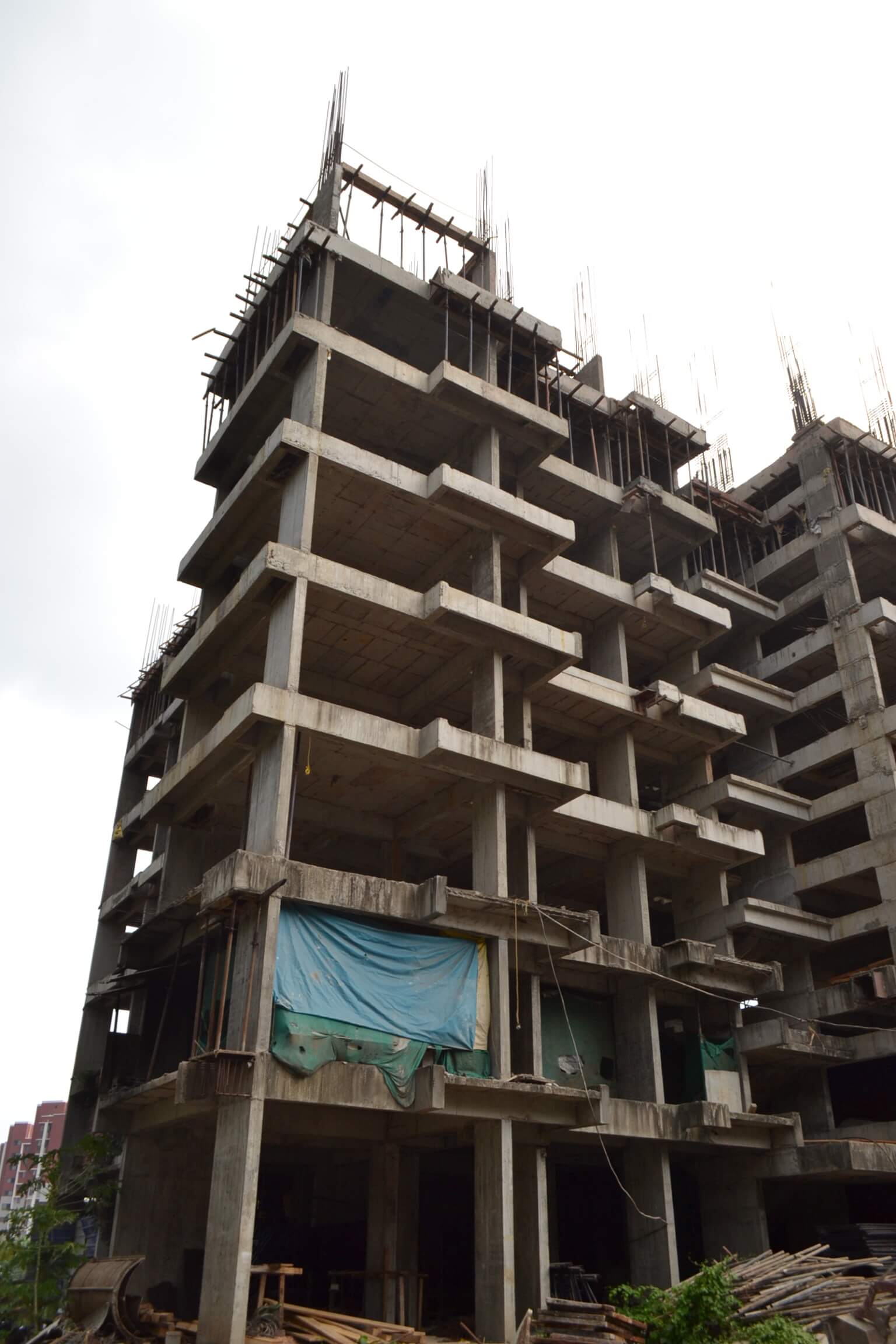

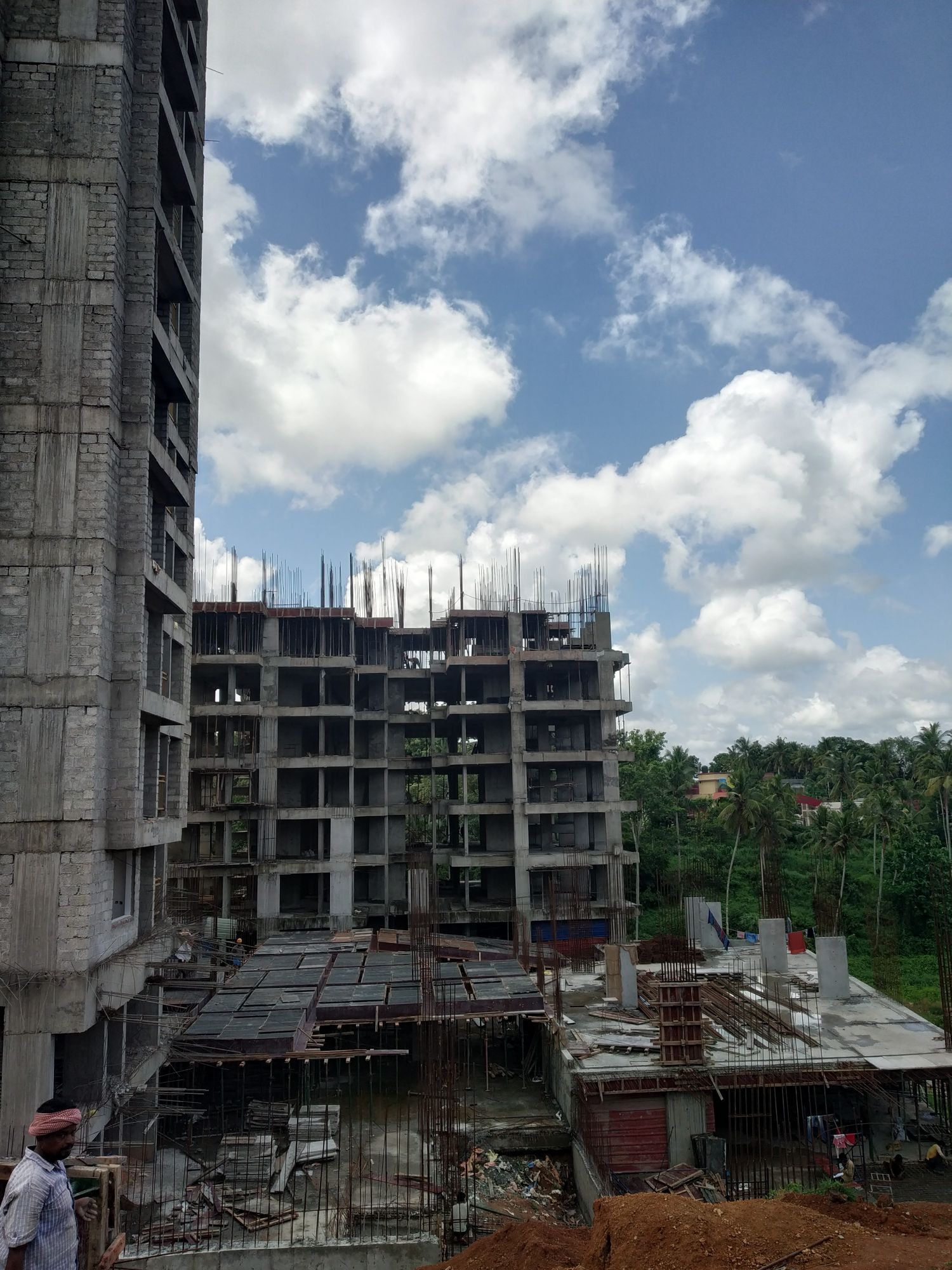

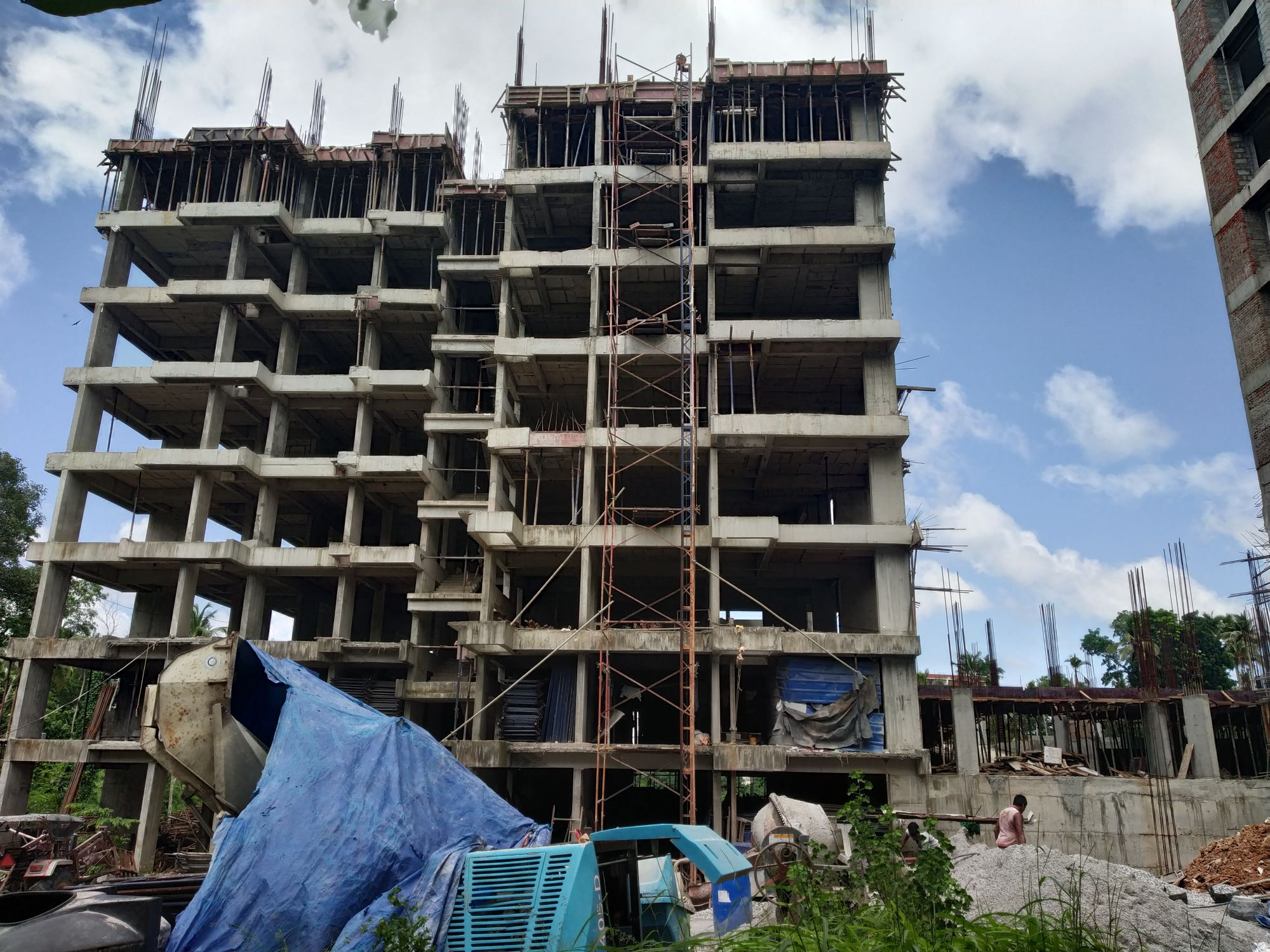

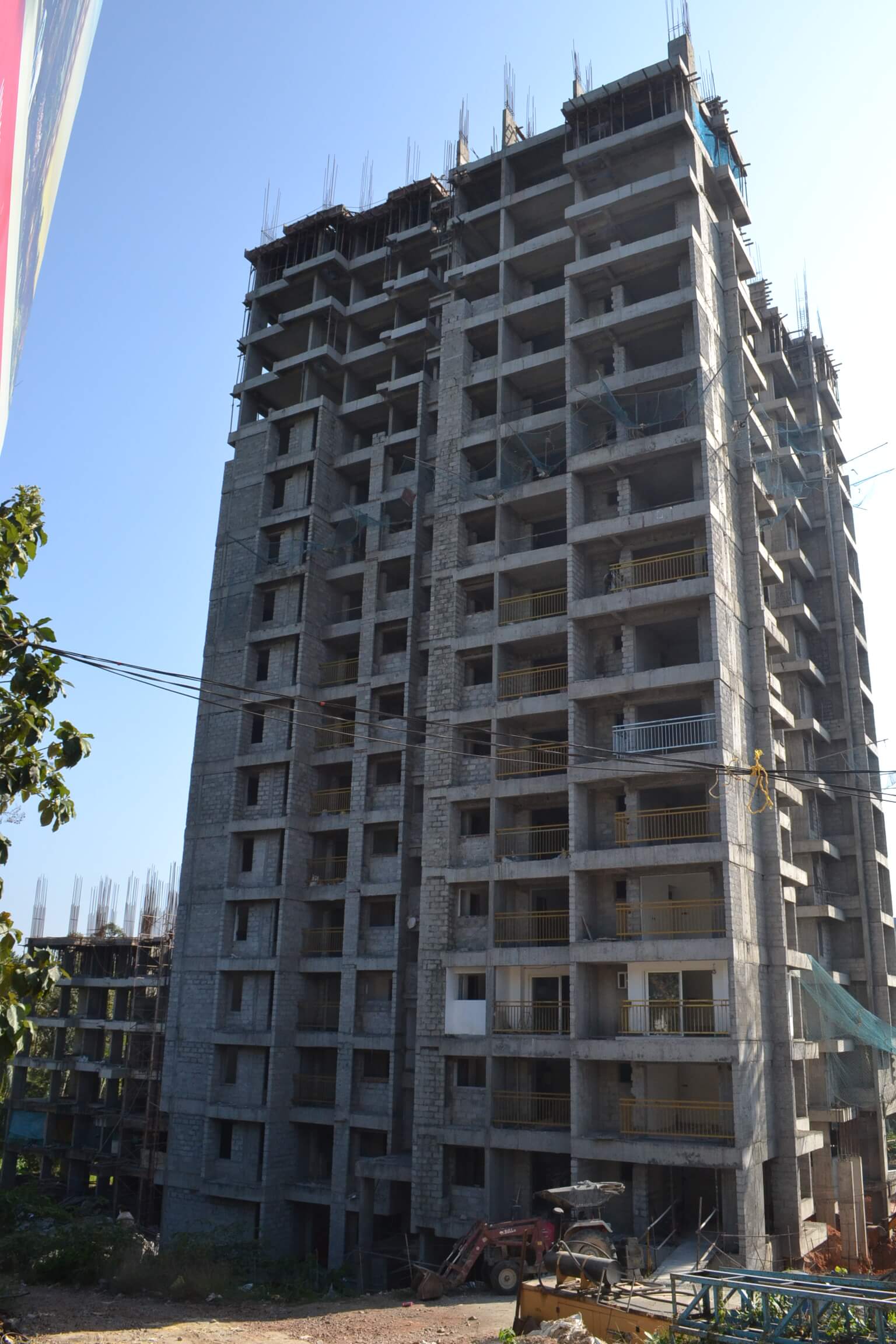

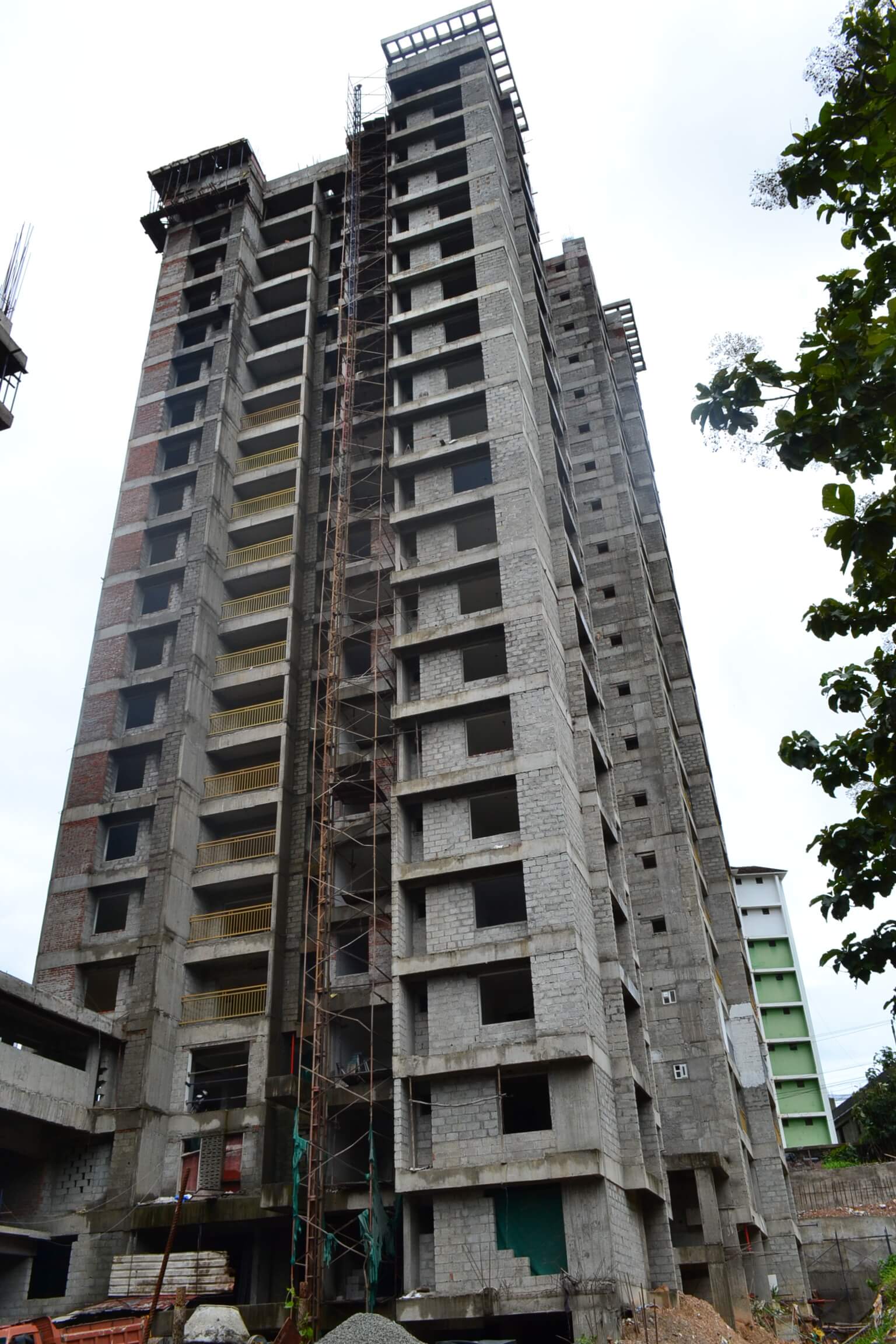

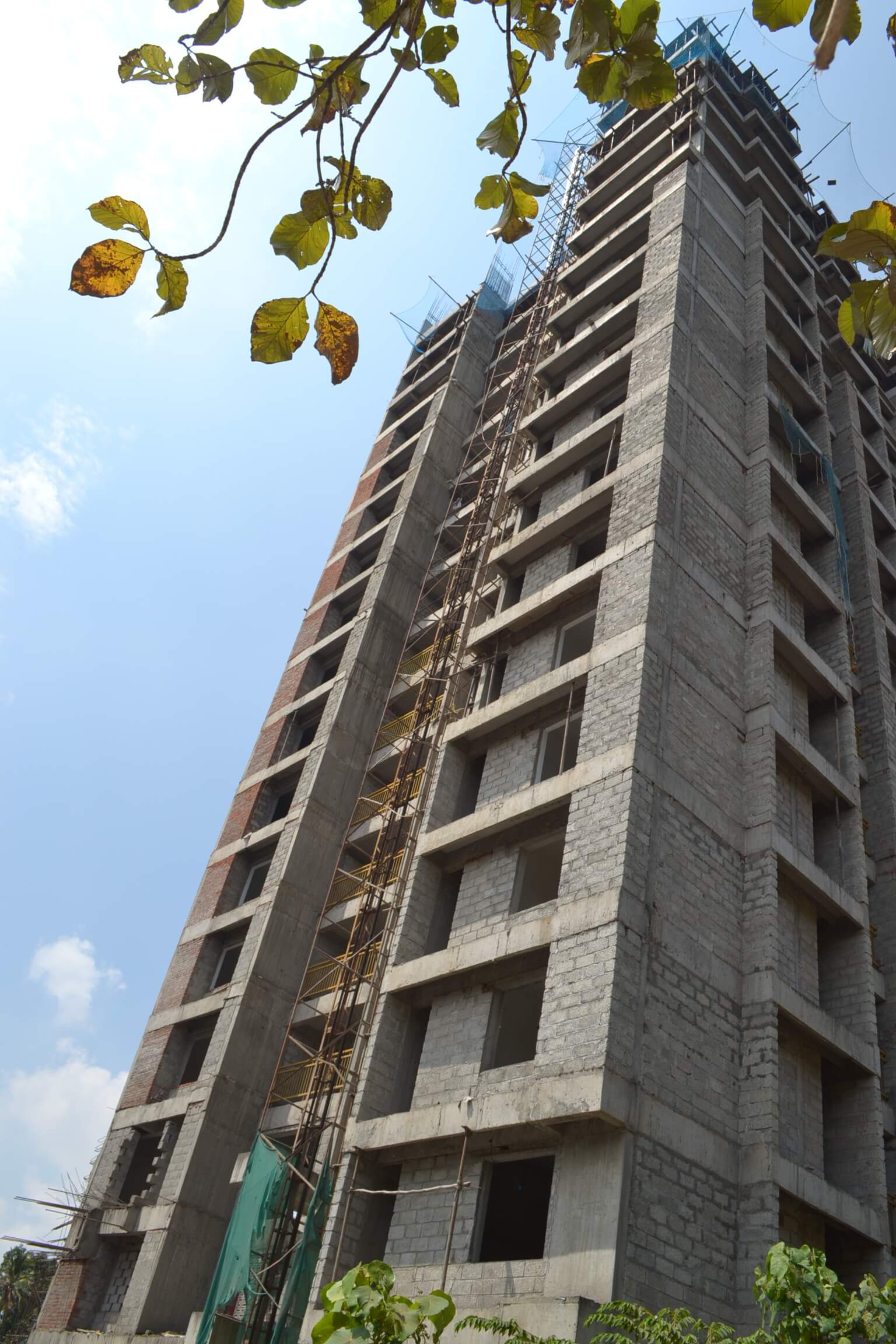

Work status as on 09-02-2021, we have completed the following
Tower 1
- RCC for slab -18th floor-19th floor-100% completed, water tank 100% completed.
- Block work – BF2-90% completed,BF1,1st-18 th floor:-100%completed, Roof:- 100 % completed.
- Ceiling Plastering work -(BF1- 18th floor -) 100% completed.
- Wall chasing work -BF1- 18th floor – 100% completed.
- Door Frame Fixing -BF1-90% Completed,1-18th -100% completed.
- Internal wall plastering work -upto 18th floor -100% completed, Roof-50% completed.
- Outside Plastering:- 95% completed.
- Dadoing of toilets: up to 15th floor -100% completed.
- Dadoing of kitchen walls :GF – 50% completed,1st floor-13th floor-100% completed,
- Wire pulling : GF -30%,1st and 3 rd,5 th ,7 th -90%,2,4,8th -25% completed,6th,9th-15th floor-100% completed,
- Water Proofing work – Upto 18th floor- 100% completed,terrace -25% completed
- Putty work – upto 18th floor :-100% completed.
- Internal Primer -second coat :- upto 15th floor-100% completed.
- External Painting -(1st coat) :-at south -75% completed, at west- 40% completed
- External Primer -(2nd coat) :- at south -75% completed, at west- 20% completed
- Outside Putty work -15% completed
- Plumbing work – upto 16th floor- 100% completed
- Grills /Balcony Handrail work -upto 18th floor -100% completed,
- Flooring and skirting ,, -GF,15th floor-25% Completed 3rd-5th ,7th,8th,11th,12thfloor:-100% completd,1st,6th,9th,10th floor -80% completed,,13th-14th floor:-50% completed.
- Fixing of door shutters -1st Floor -25%completed
- Fire Fighting work :GF-12th floor-75% completed,13th floor-50% completed,14th-15th floor -20%completed.
- First and second coat painting ,CP and sanitary fittings ,DB Dressing ,Switch Fixing ,Final cleaning and pointing -First floor -25% completed.
- Aluminium windows & ventilators-GF,18th floor( B)-40% completed
- mock up flat – -100% completed
Tower 2

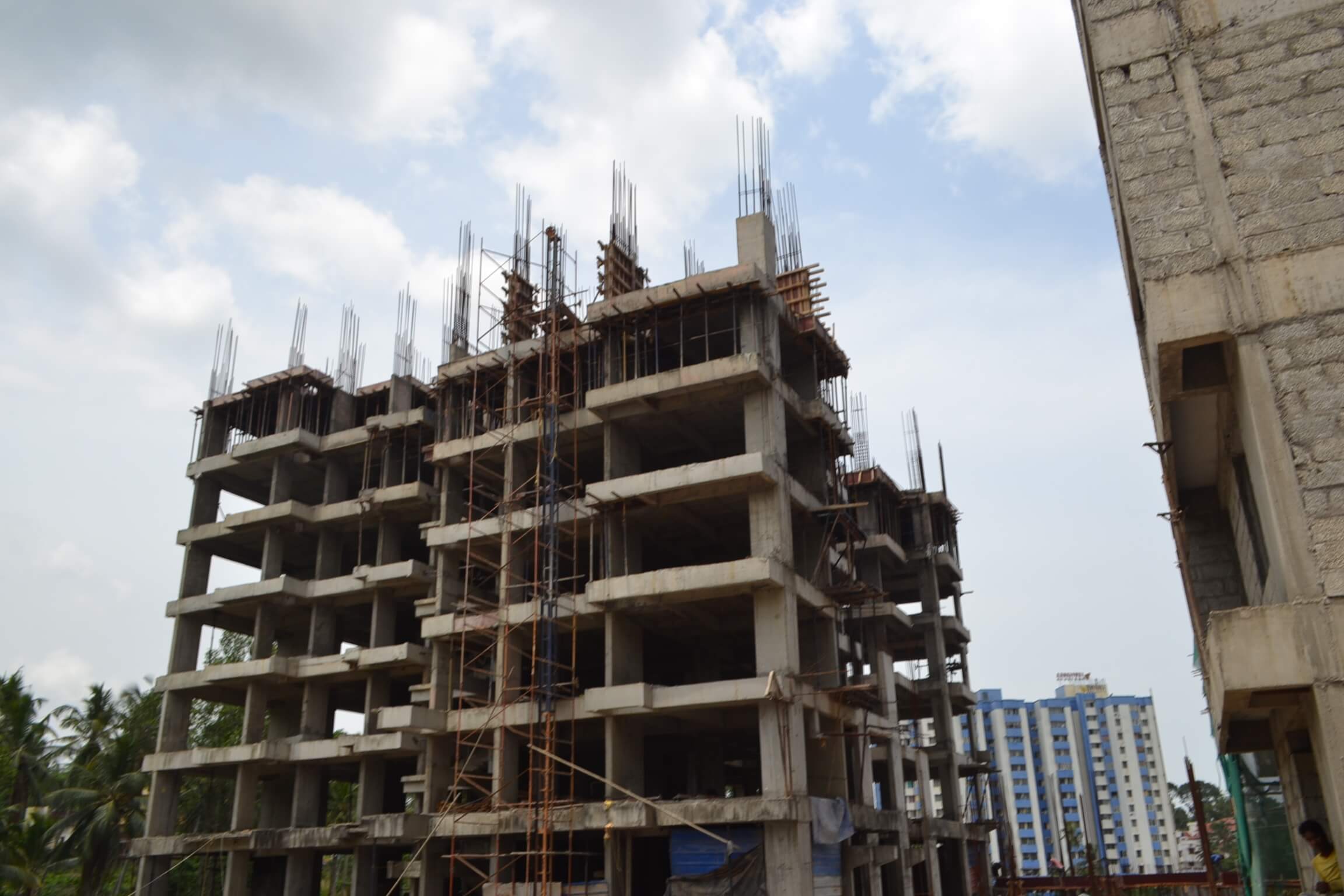

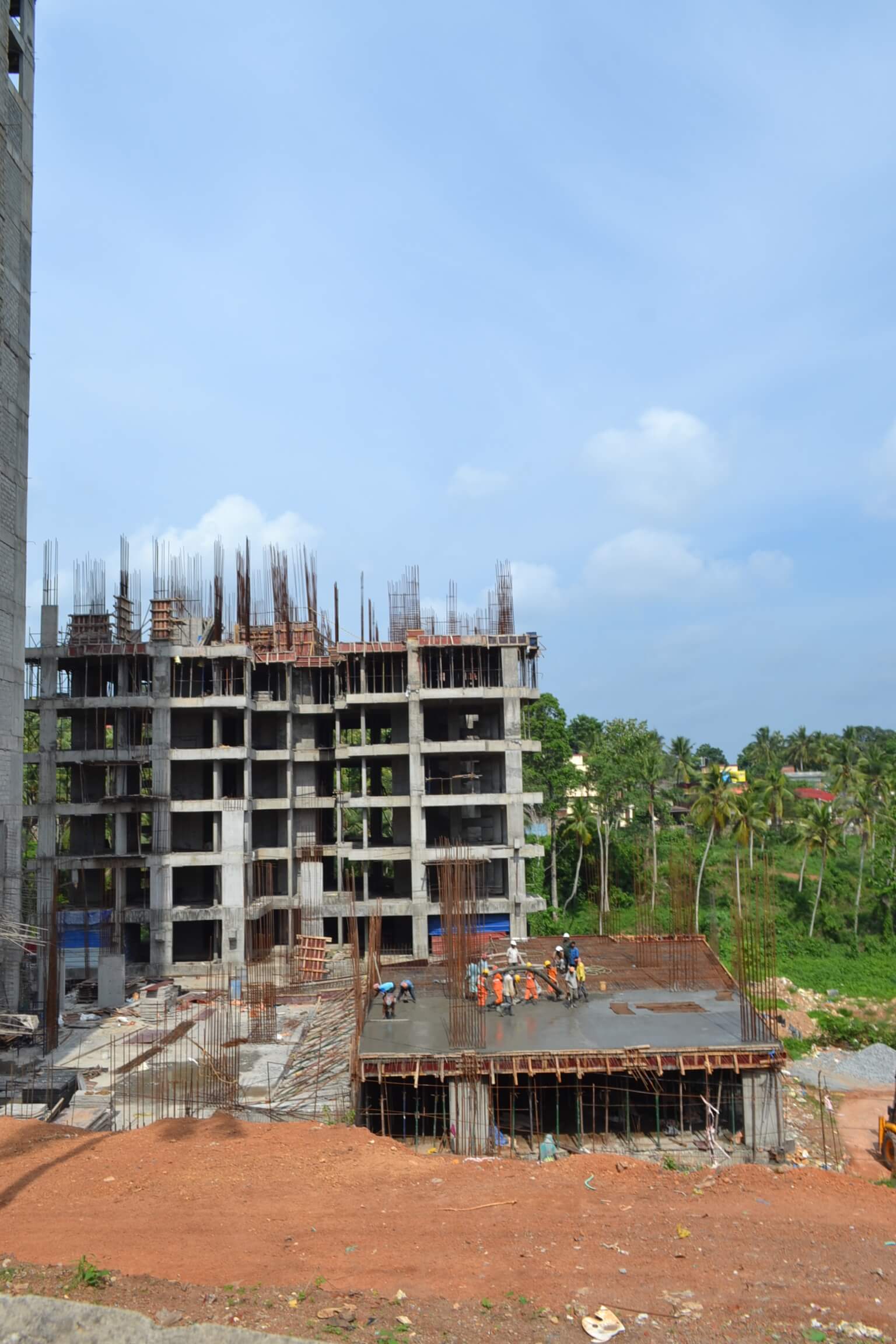

- RCC for slab – BF2-9th floor roof slab – 100% completed
- 10th roof slab -100% completed,11th floor-30% completed.
- Ceiling plastering: BF1-7th floor -100% completed, BF3-90% completed
- Electrical Wall Chasing: Ground floor -100% completed, 1st floor-2nd floor- 100 % completed ,3rdfloor-70% completed
- Wall Plastering: GF :-35% completed, 1st floor :-100% completed, 2nd floor-50% completed.
- Block Work: GF -75% completed, Basement floor:-70% completed, 1st floor-4nd floor – 100 % completed, 5th floor-75% completed
- Yard work: STP RCC -20% completed, Front gate -100% completed, Compound wall-100% completed.
- MLCP: BF1 ceiling & column plastering -100% completed, BF2 ceiling & column plastering -80% completed.

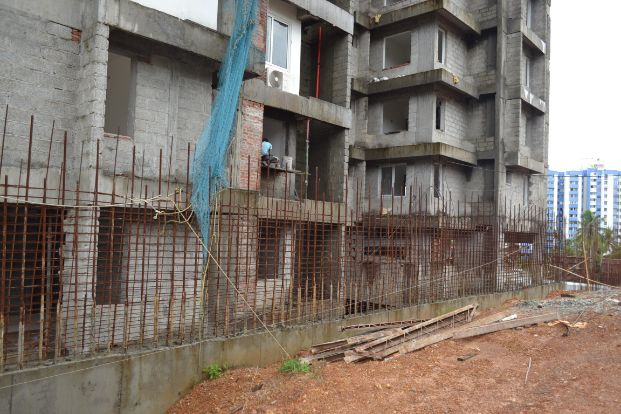

As per the current work status from our site we are targeted to complete the following works by end of JANUARY 2021
Tower 1
- Blockwork – roof:-100% to be completed.
- Internal wall plastering work -Roof-50% to be completed.
- Outside Plastering:- 100% to be completed.
- Dadoing of toilets: 15th-16th floor -100% to be completed
- Dadoing of kitchen walls: 13th floor-14th floor-100% completed,
- 15th-17th floor -100% to be completed,
- Water Proofing work -18th floor, terrace -100% to be completed
- Putty work:- 18th floor -100% to be completed.
- Internal Primer -second coat:-15th -16th floor:-100% to be completed.
- External Primer -(first coat):- at south -100% to be completed, at west- 100% to be completed.
- External Painting -(Second coat):- at south -50% to be completed, at west- 50% to be completed.
- Outside Putty work -40% to be completed
- Plumbing work -17th floor-100% to be completed.
- Flooring and skirting :-,14th floor- 100% to be completed, 15th floor:- 50% to be completed
- 13th-15th floor- 100% to be completed.
- Aluminium windows & ventilators-GF,18th floor(B)-100% to be completed.
Tower 2
- RCC for slab -11th roof slab -100% to be completed.,12th-30% to be completed.
- Ceiling plastering: 8th -9th floor,BF3 -100% to be completed
- Electrical Wall Chasing: 3rd-4th floor:-100% to be completed.

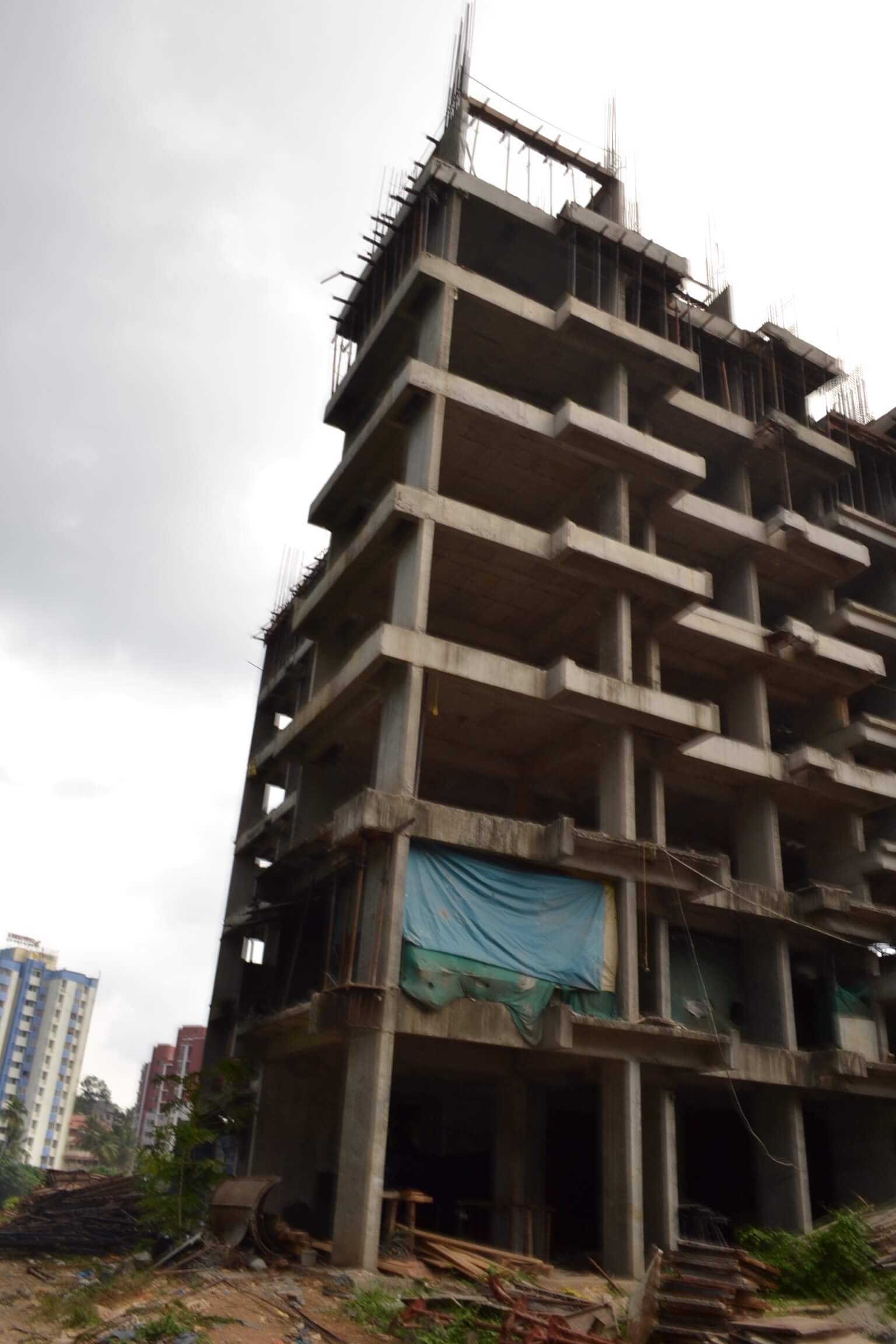

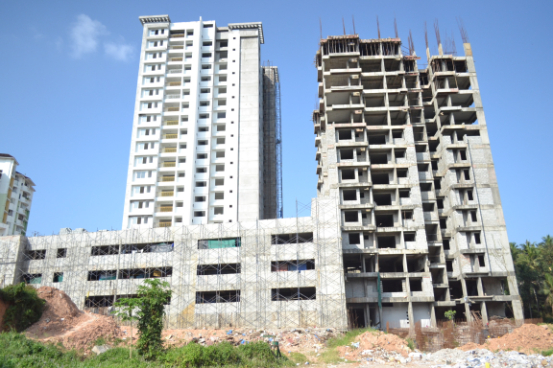

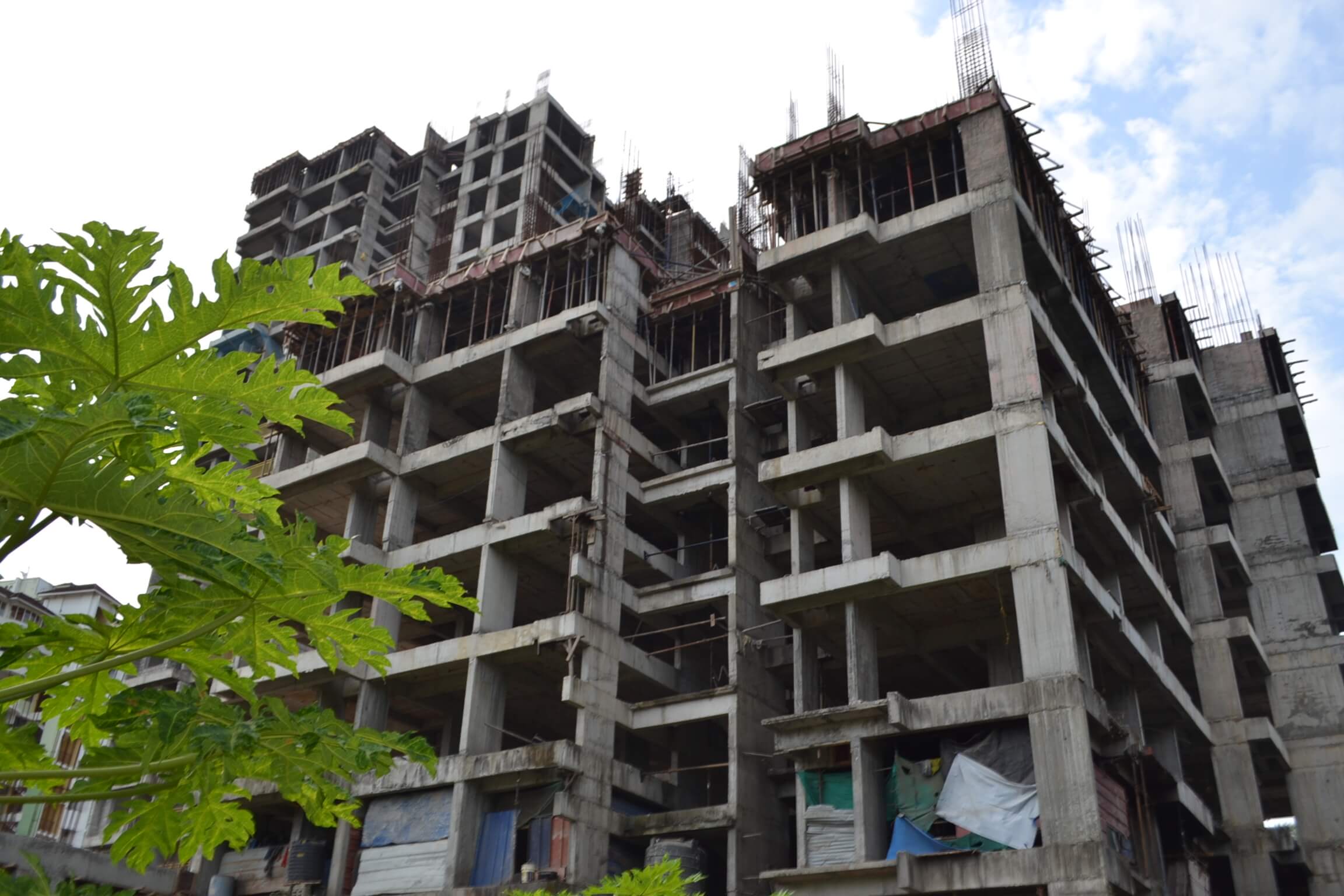

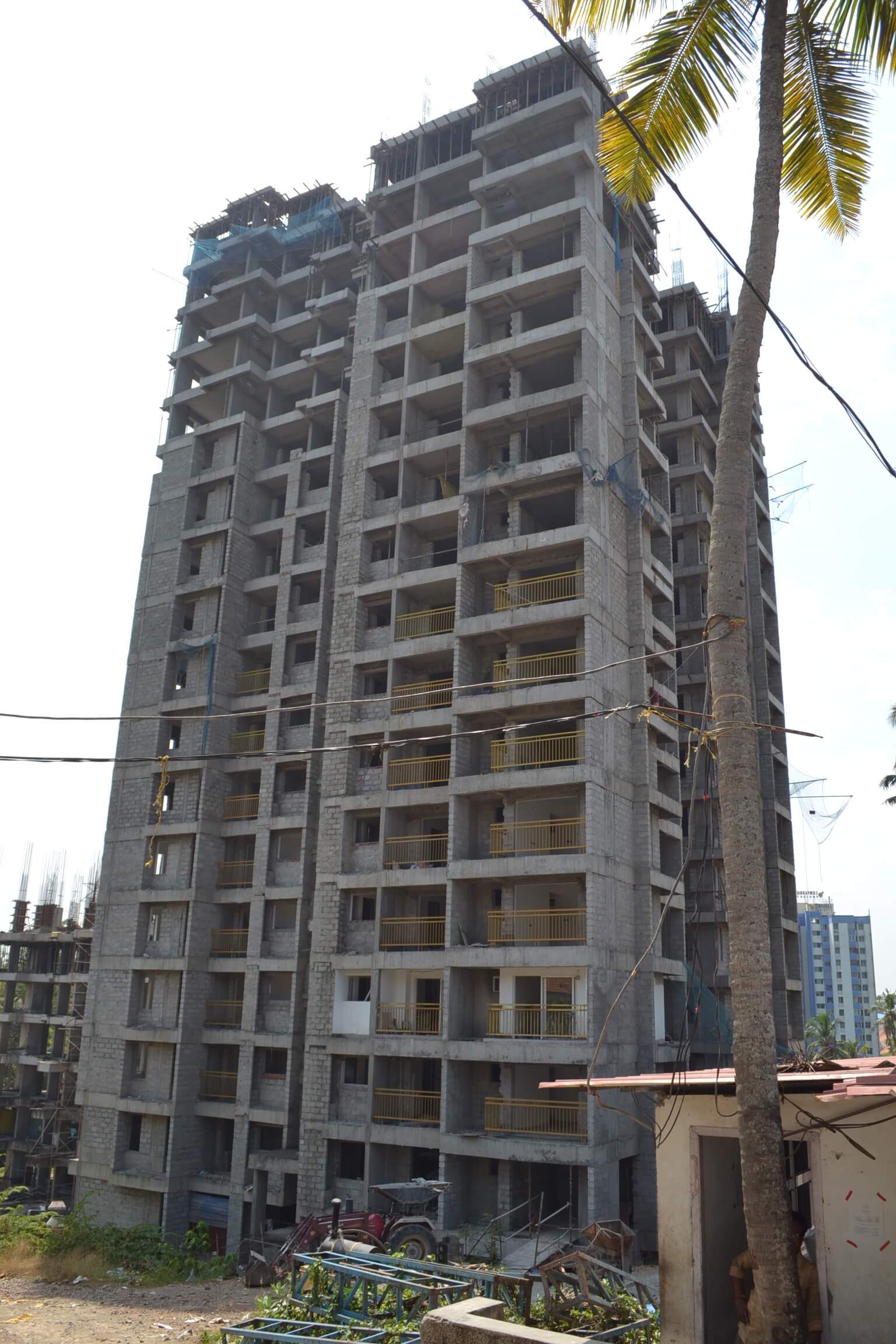

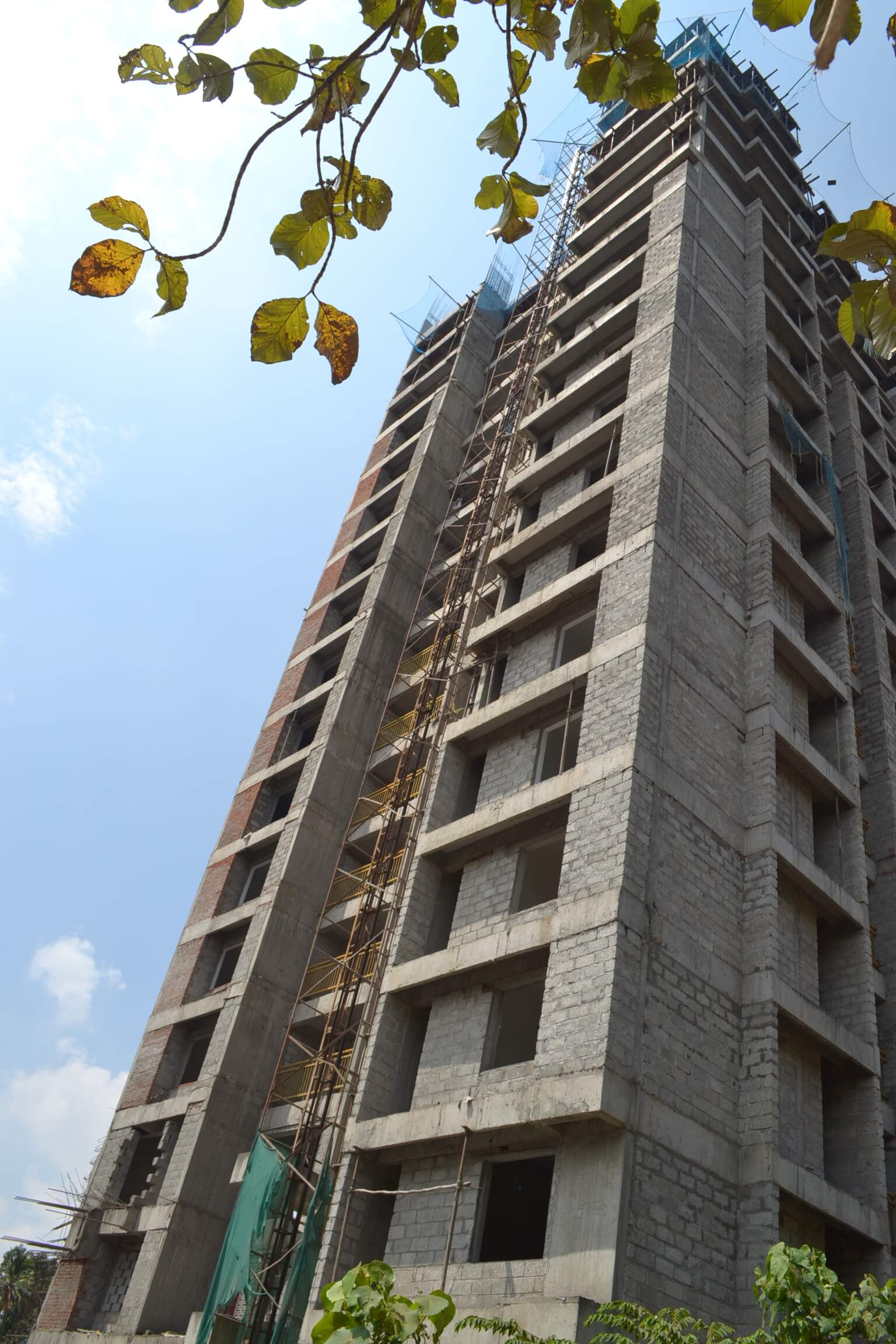

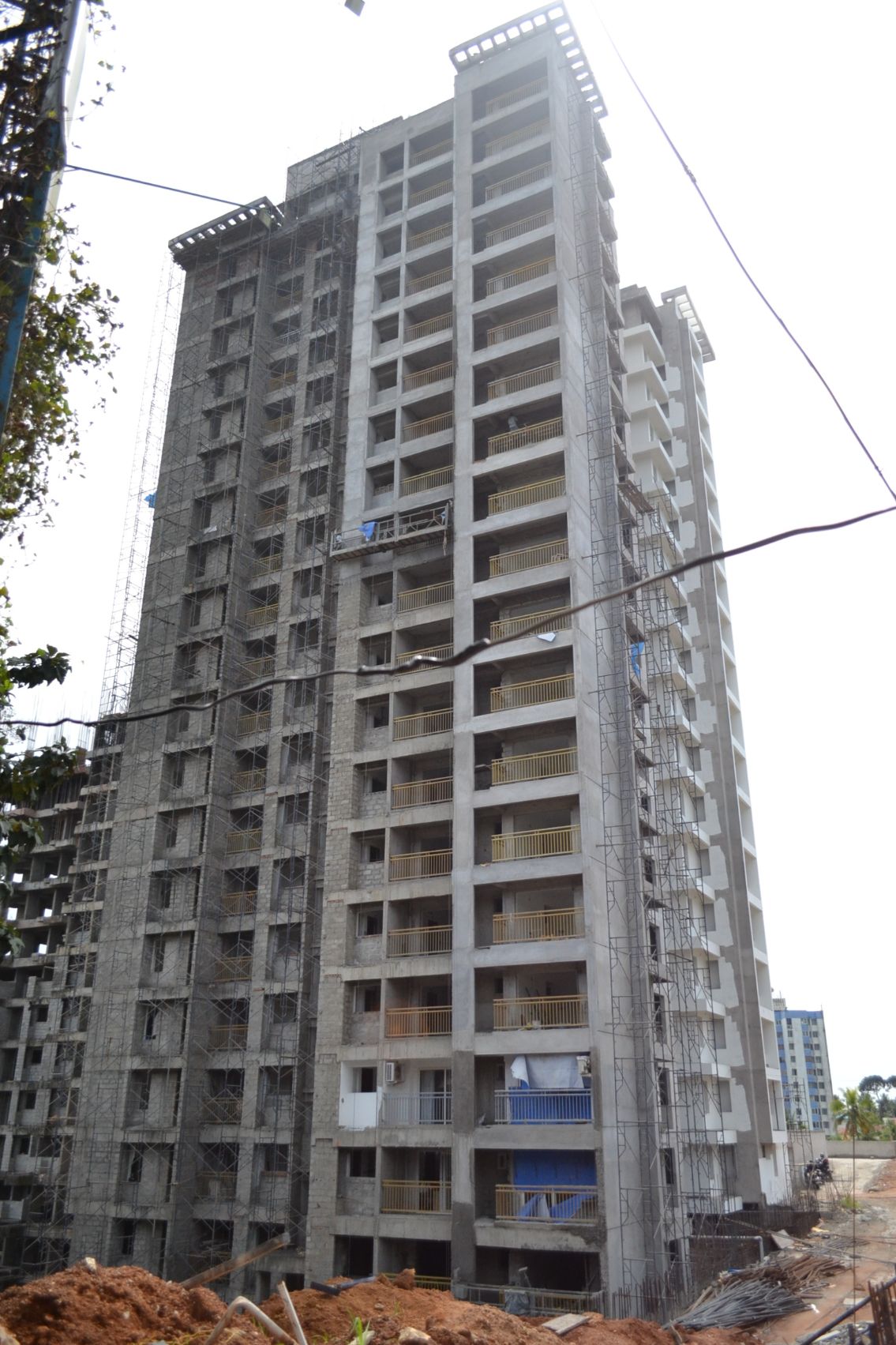

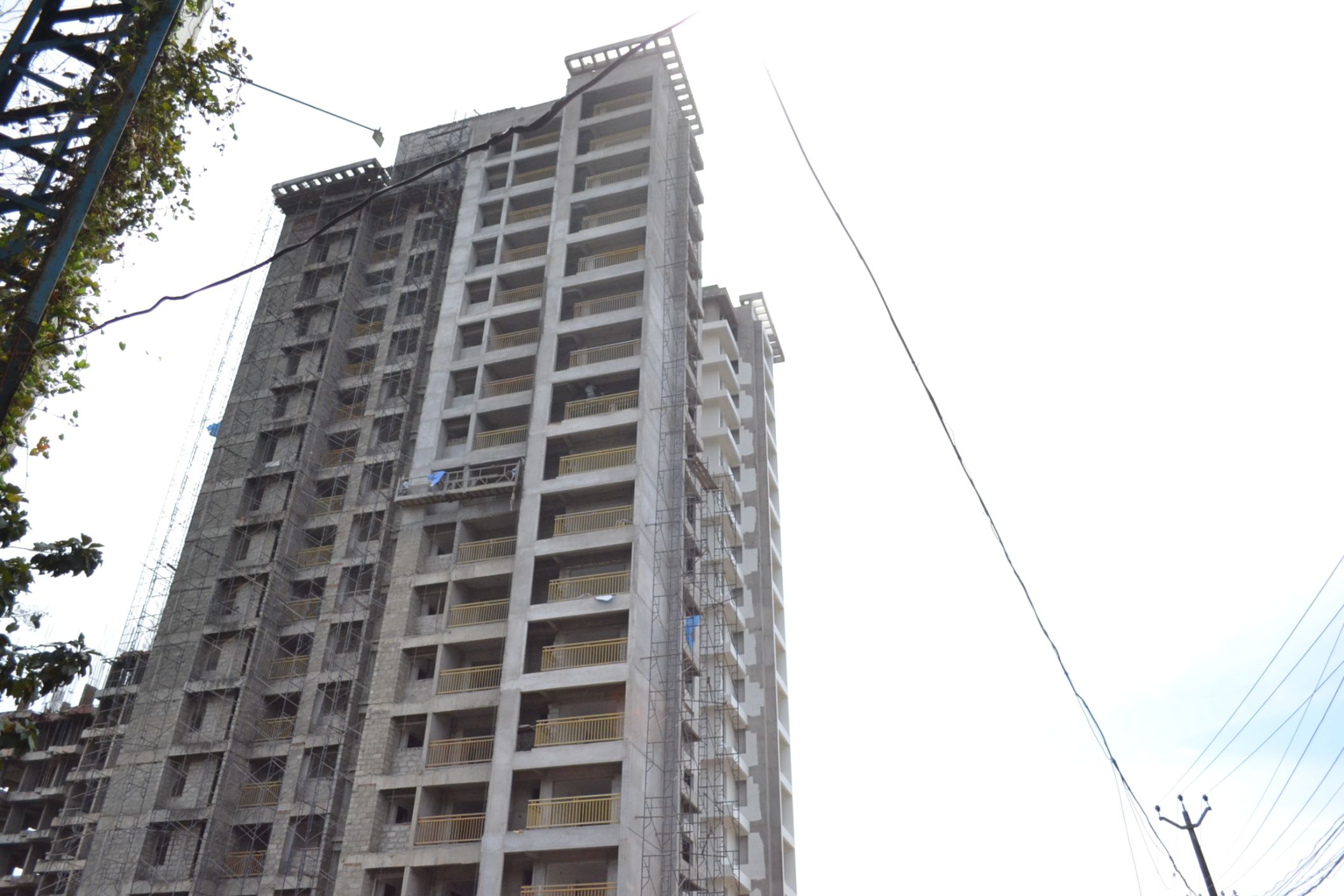

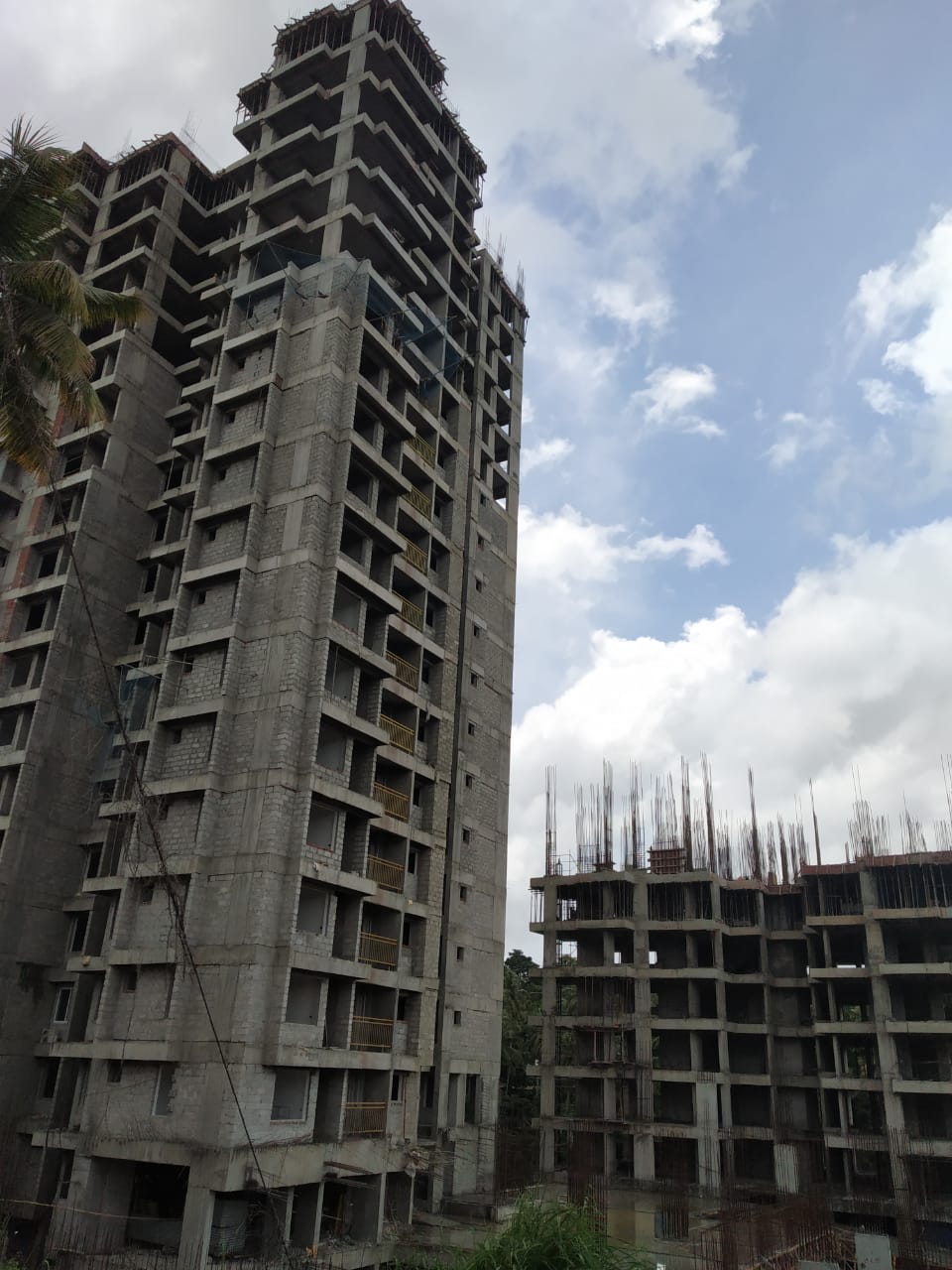

- Wall Plastering: GF:-100% to be completed, 1st -2nd floor:-100% to be completed.
- Block Work: Basement floor:-100% to be completed, 5th & 6th floor -100% to be completed.

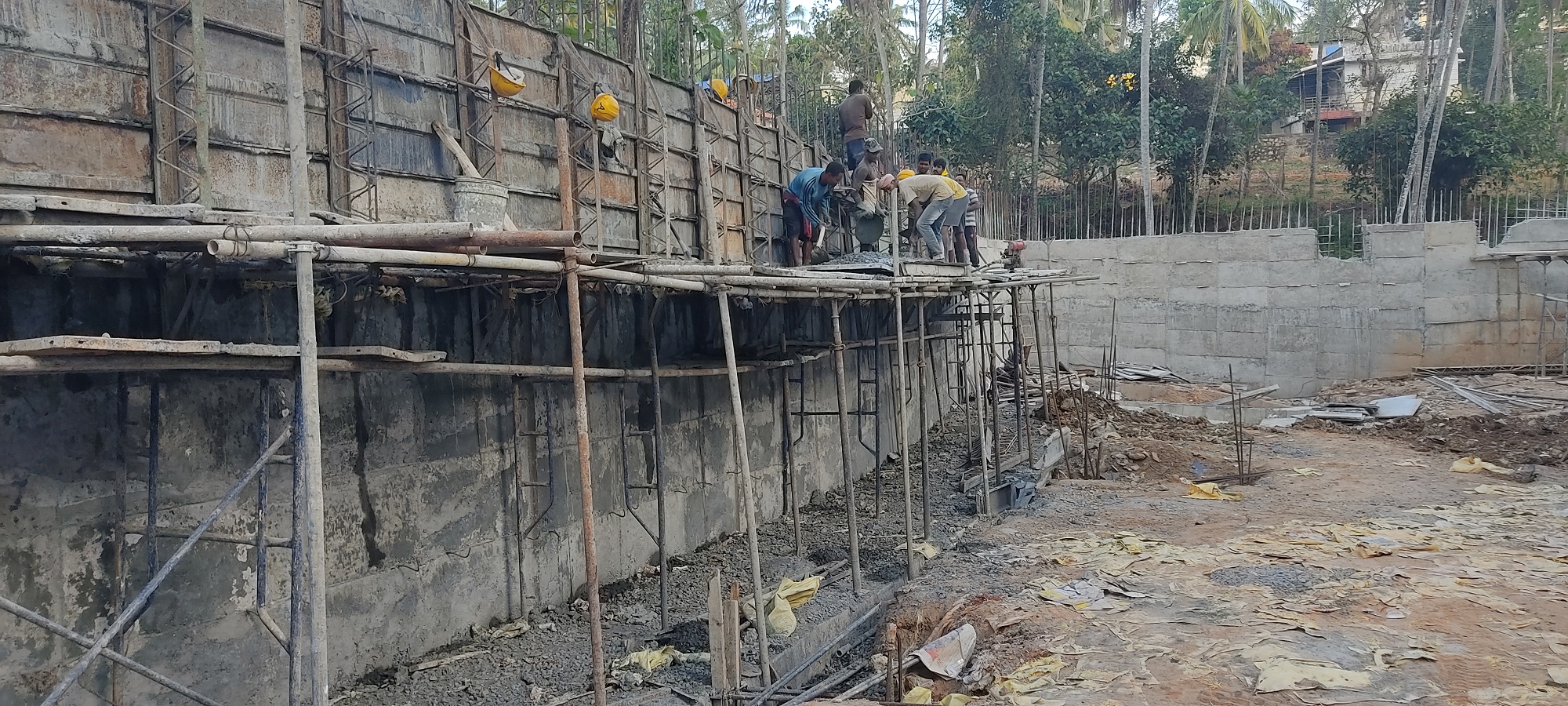

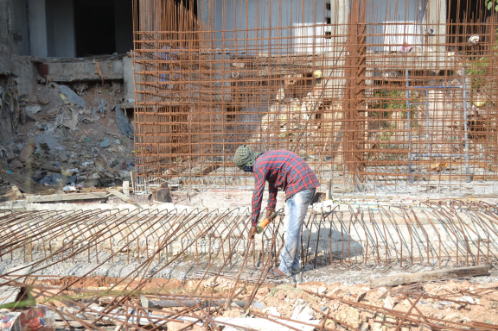

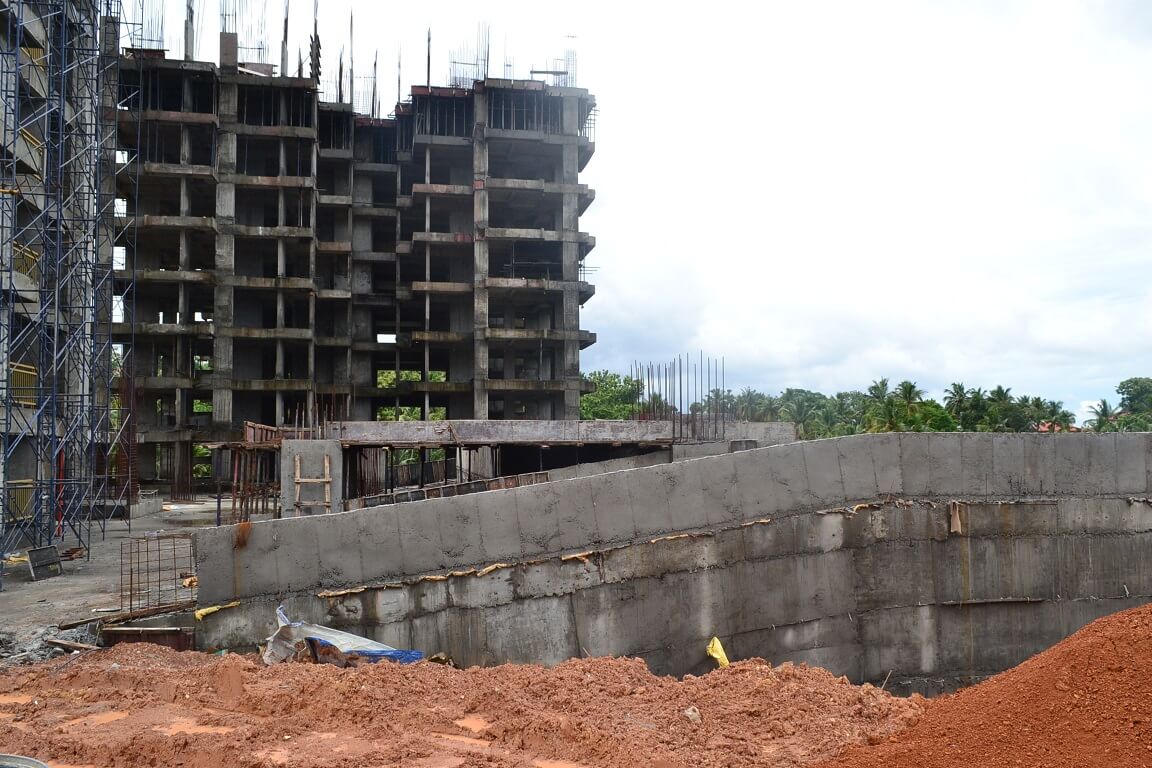

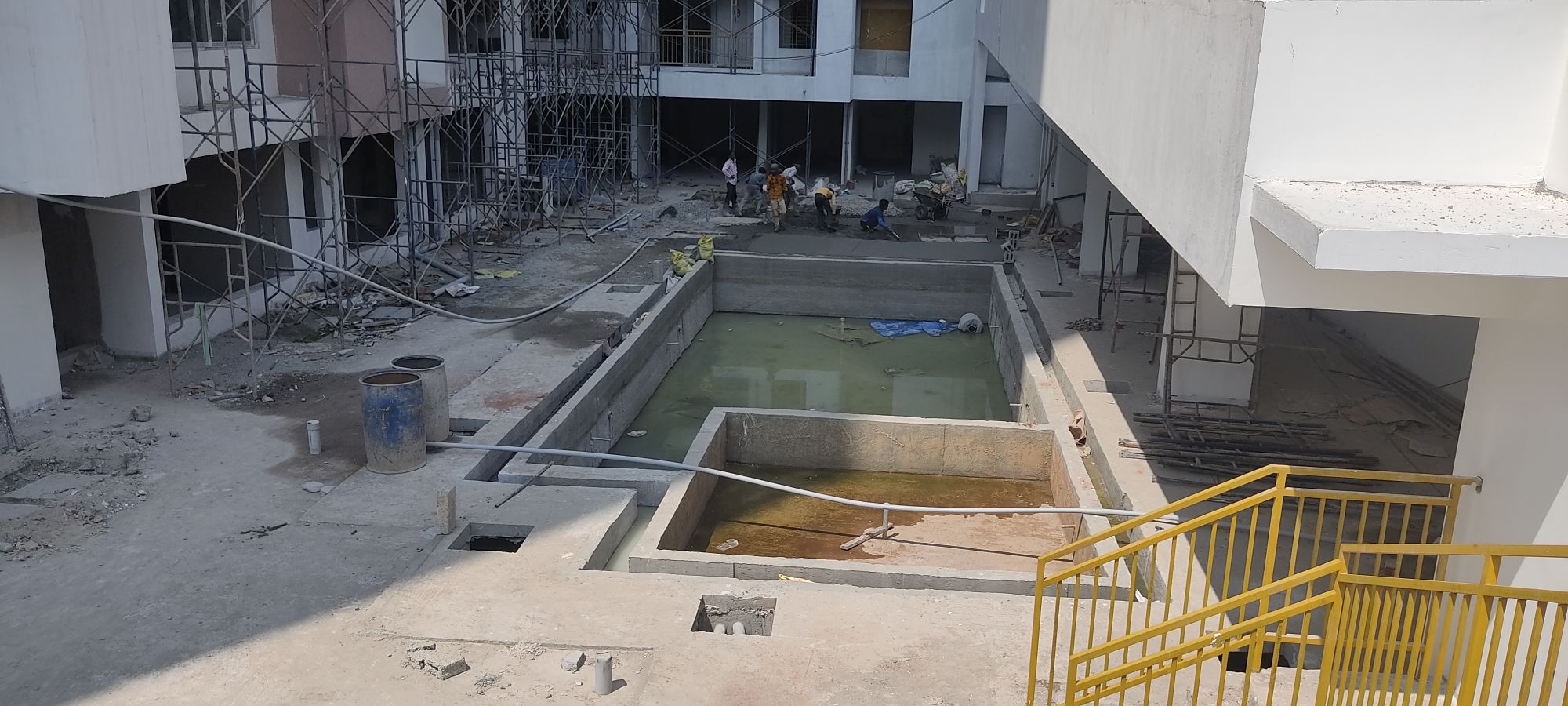

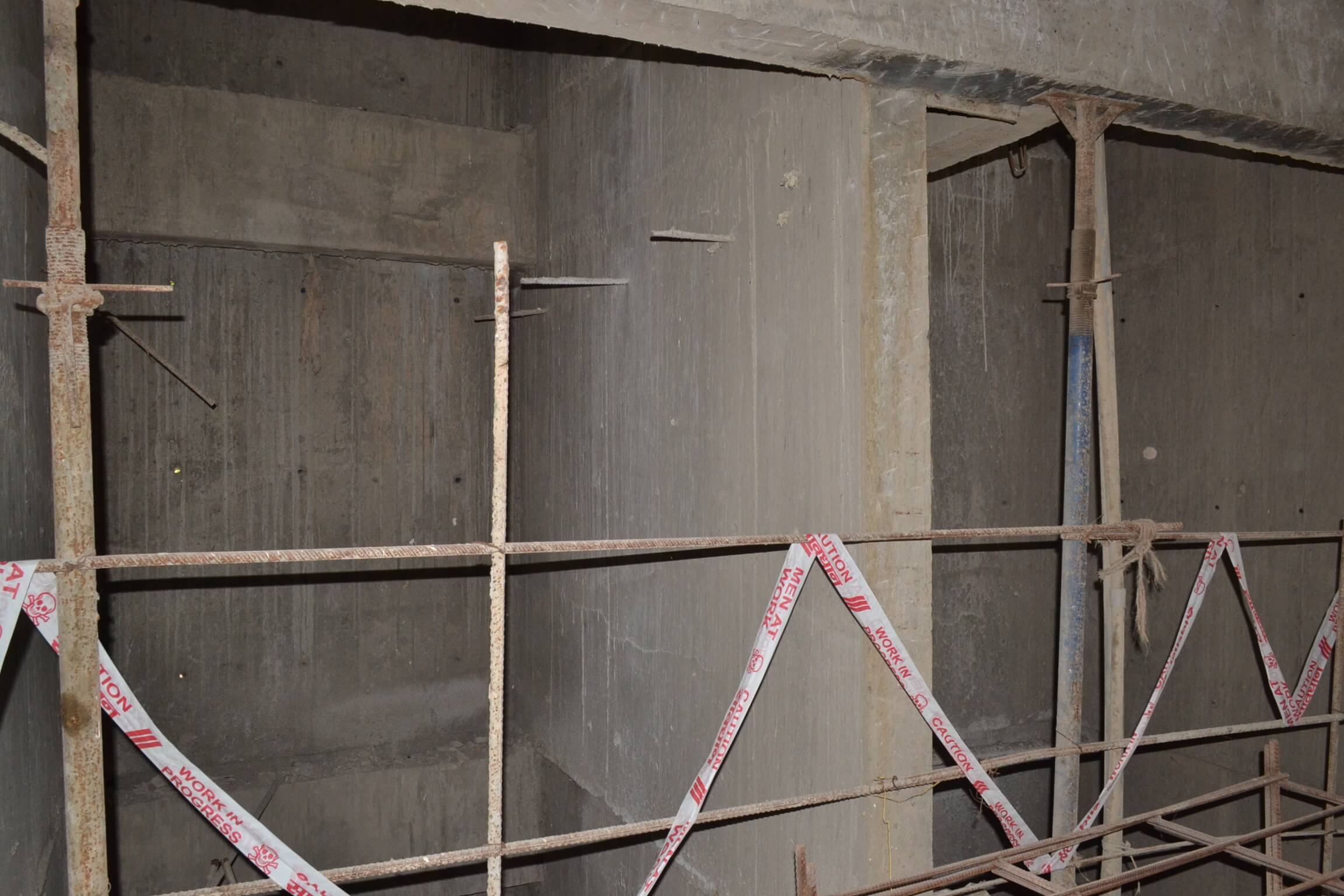

- Yard work: full side retaining wall-40% to be completed, STP RCC -75% to be completed.
- MLCP: BF2 ceiling & column plastering -100% to be completed, BF3 ceiling & column plastering -100% to be completed.

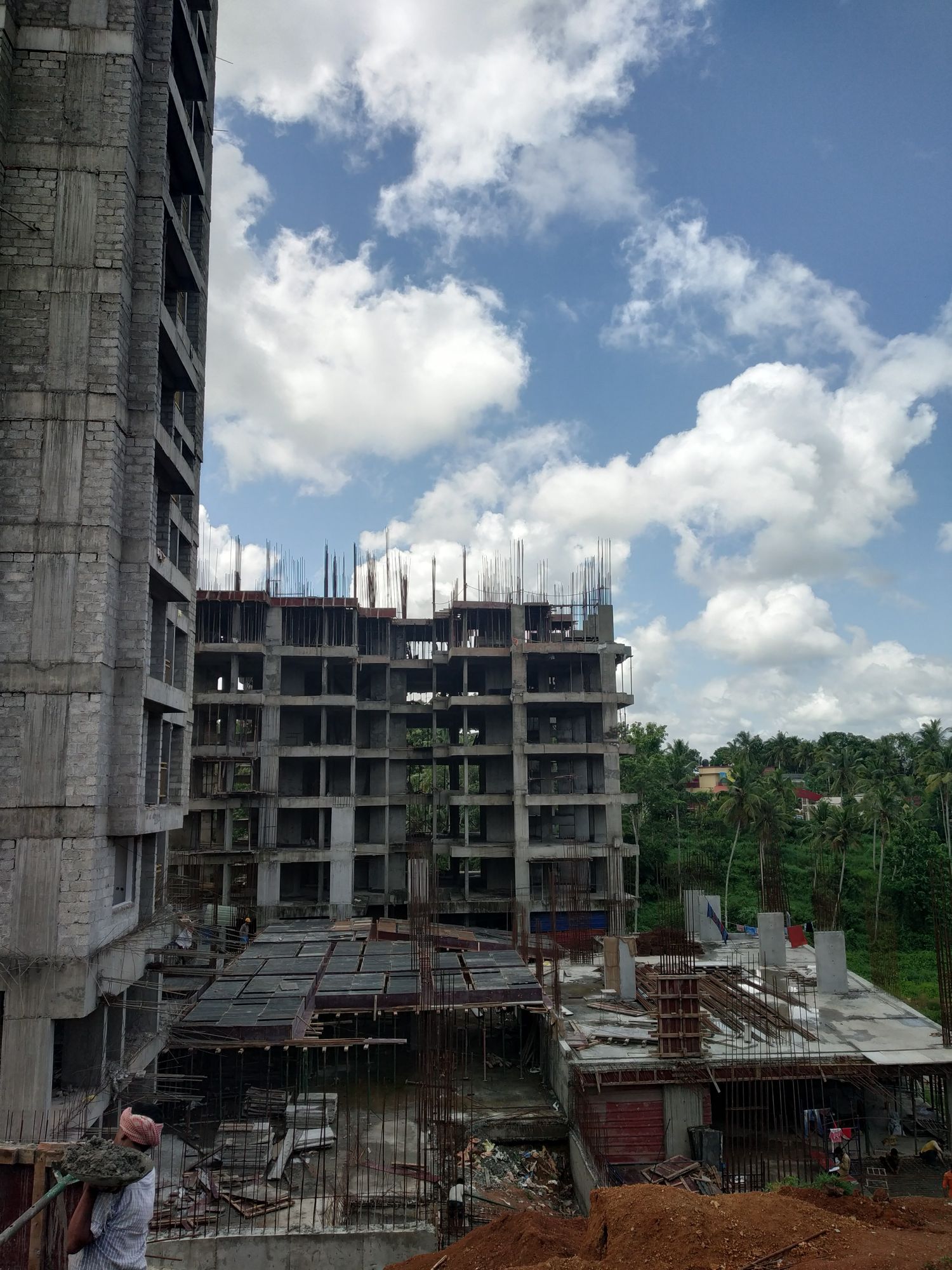

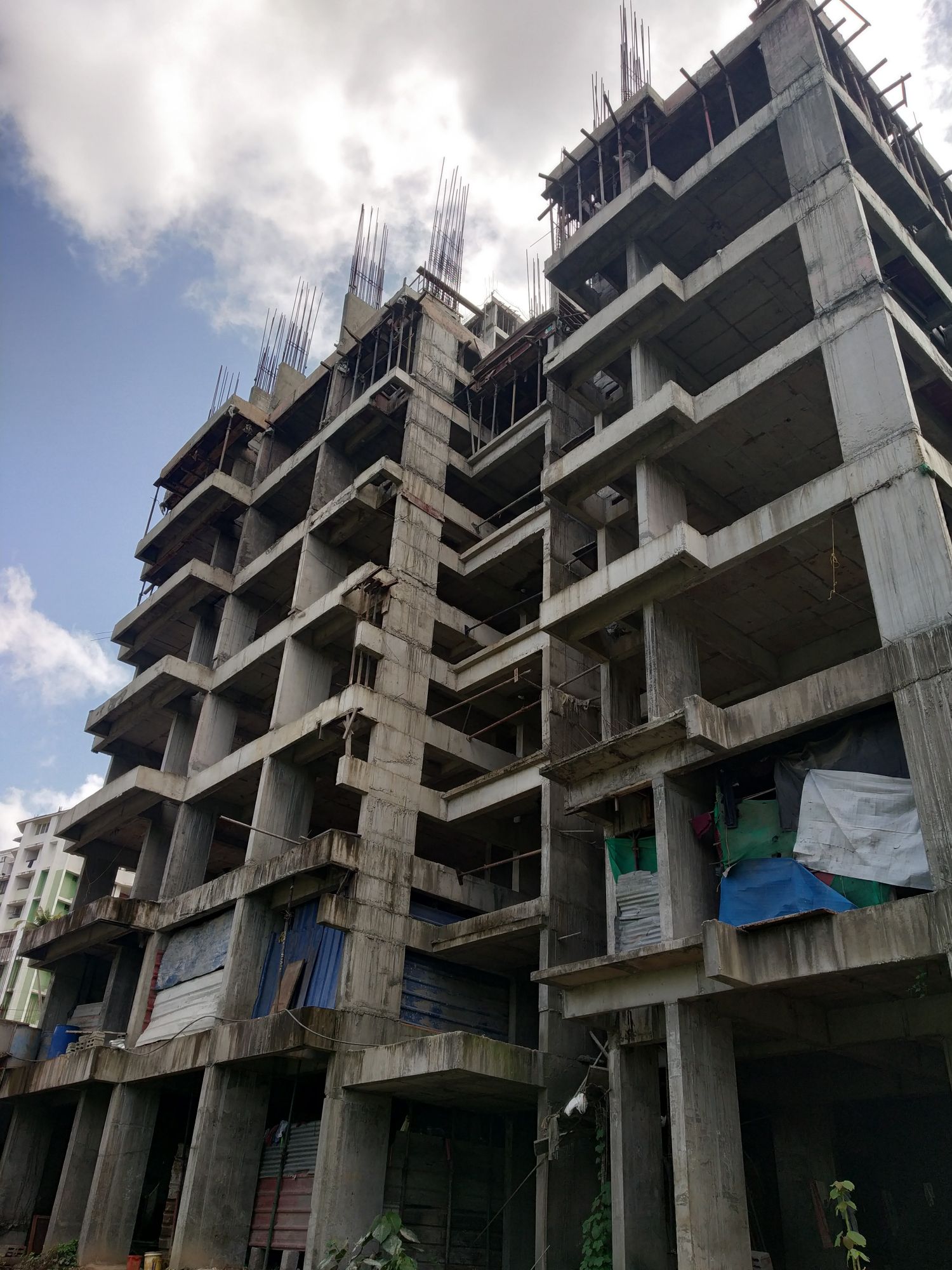

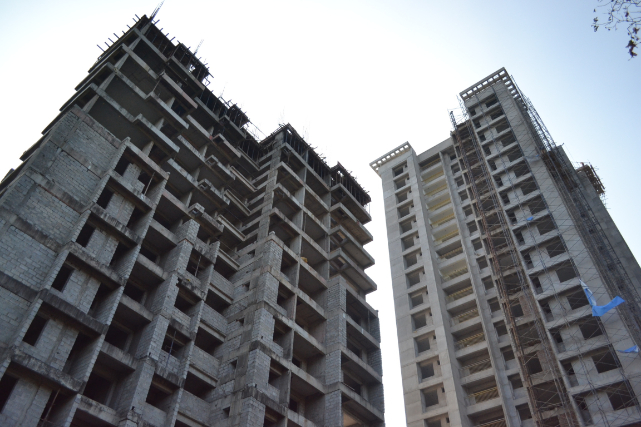

Work status as on 07-01-2021, we have completed the following
Tower 1
- RCC for slab -18th floor-19th floor-100% completed, water tank 100% completed.
- Blockwork – BF2-90% completed,BF1,1st-18 th floor:-100%completed, Roof:- 80 % completed.
- Ceiling Plastering work -(BF1- 18th floor -) 100% completed.
- Wall chasing work -BF1- 18th floor – 100% completed.
- Door Frame Fixing -BF1-90% Completed,1-18th -100% completed.

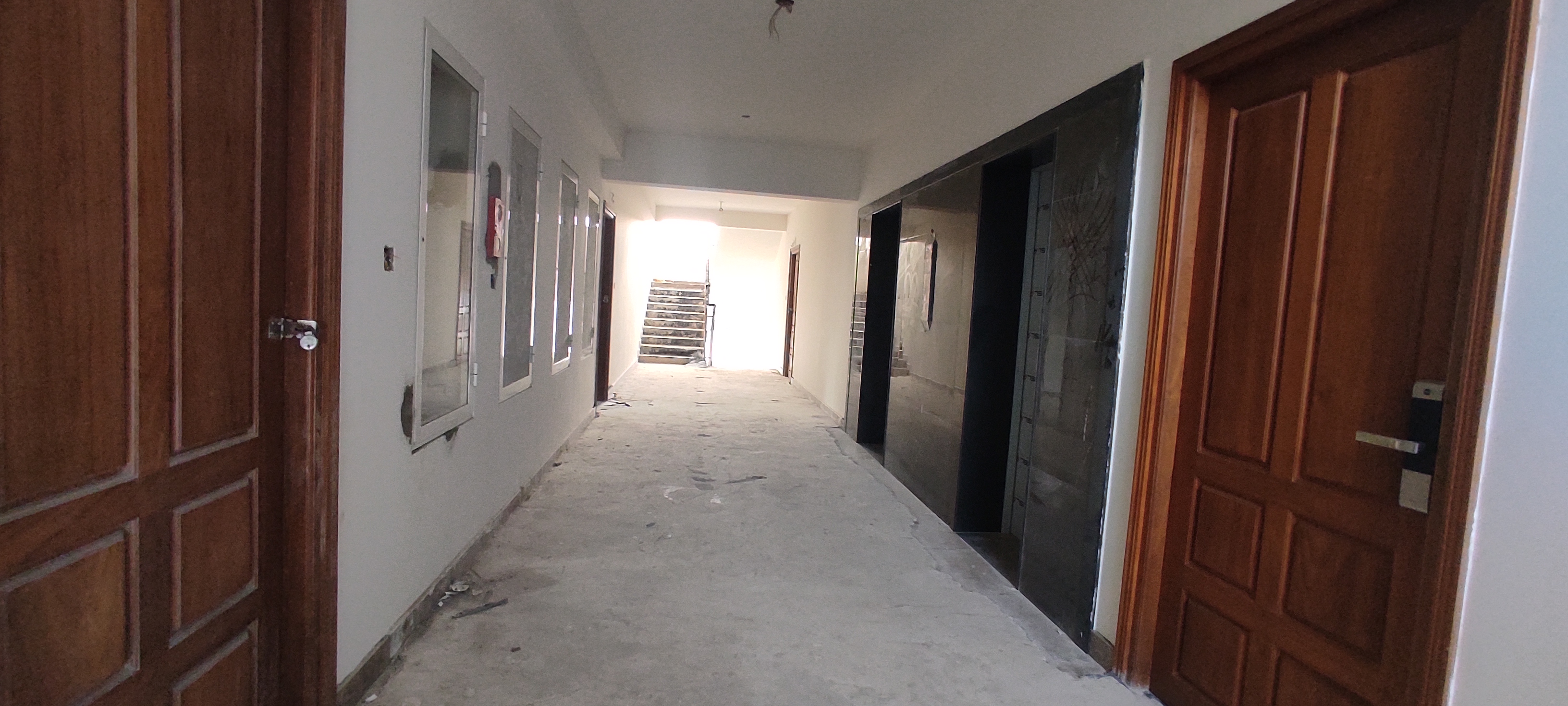

- Internal wall plastering work -up to 18th floor -100% completed, Roof-20% completed.
- Outside Plastering:- 90% completed.
- Dadoing of toilets: up to 14th floor -100% completed.
- Dadoing of kitchen walls: GF – 50% completed,1st floor-13th floor-100% completed,
- Wire pulling : GF -30%,1st and 3 rd,5 th ,7 th -90%,2,4,8th -25% completed,6th,9th,11th,13th floor-100% completed,10th,12th floor-100% completed,
- Water Proofing work – Upto 17th floor- 100% completed,18th floor-70% completed.
- Putty work – up to 17th floor:-100% completed.
- Internal Primer -second coat:- up to 14th floor-100% completed.
- External Primer -(first coat) :- at south -25% completed, at west- 25% completed
- External Painting -(Second coat) :-
- Outside Putty work -15% completed
- Plumbing work – upto 16th floor- 100% completed,16th floor-60% completed.
- Grills /Balcony Handrail work -upto 18th floor -100% completed,

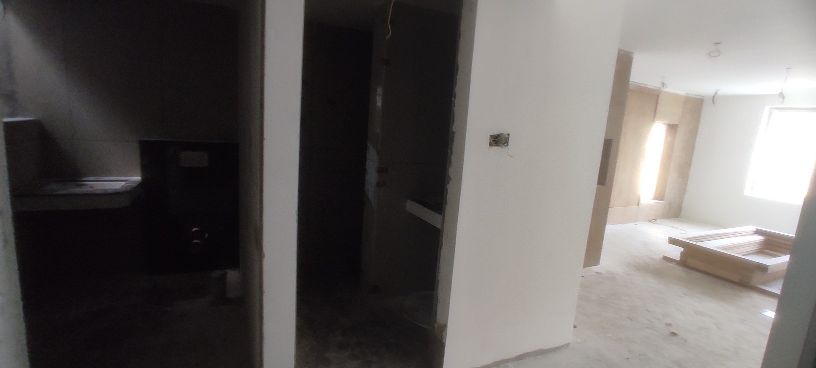

- Flooring and skirting ,, -GF, floor-25% Completed ,1st,floor :-80% completed,3rd-5th ,7th,8th,11th,12thfloor:-100% completd,6th,9th,10th floor -80% completed,,13th-14th floor:-50% completed.

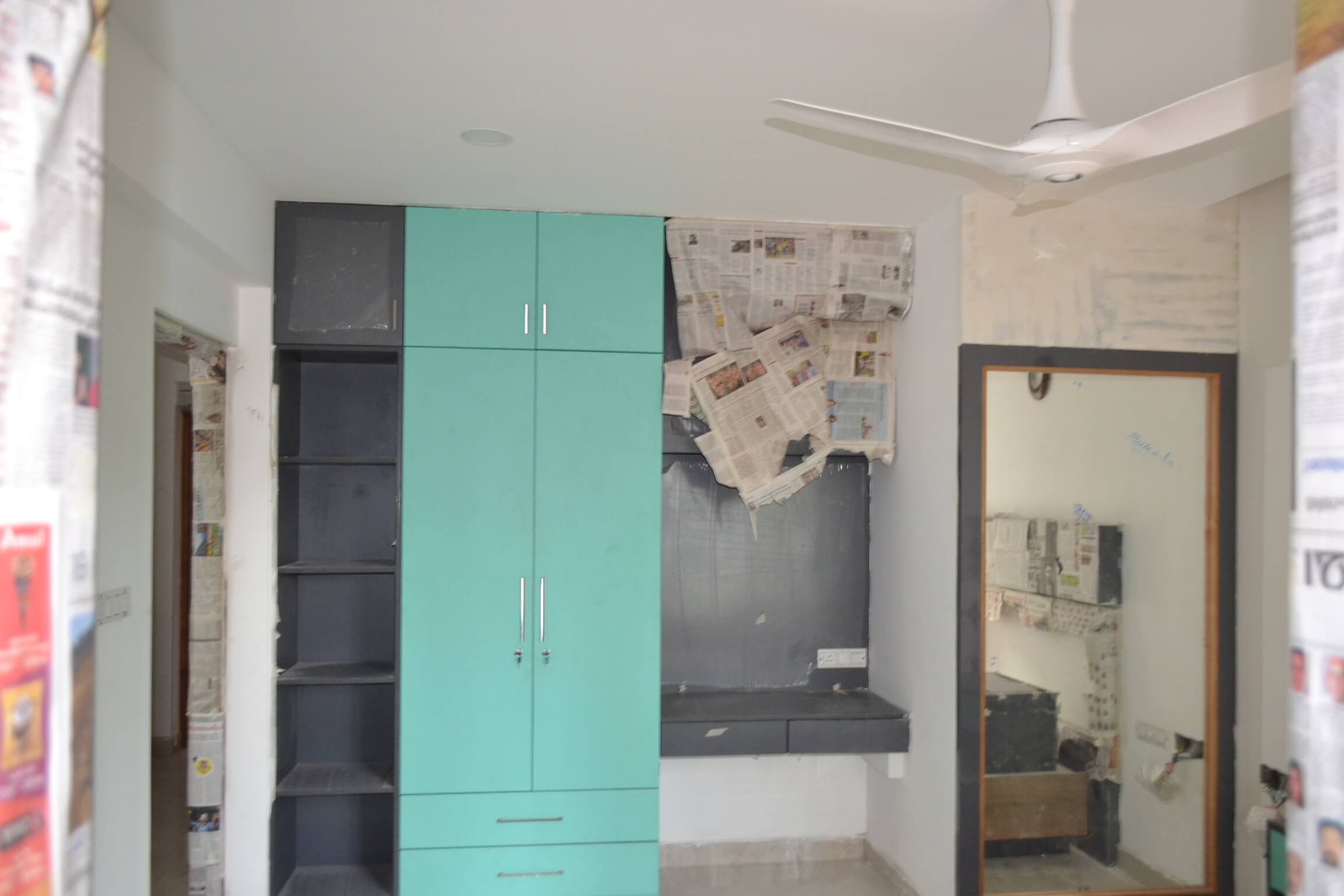

- Fixing of door shutters -1st Floor -25%completed
- Fire Fighting work :GF-12th floor-75% completed,13th floor-50% completed.
- First and second coat painting ,CP and sanitary fittings ,DB Dressing ,Switch Fixing ,Final cleaning and pointing -First floor -25% completed.
- Aluminium windows & ventilators-GF,18th floor( B)-40% completed

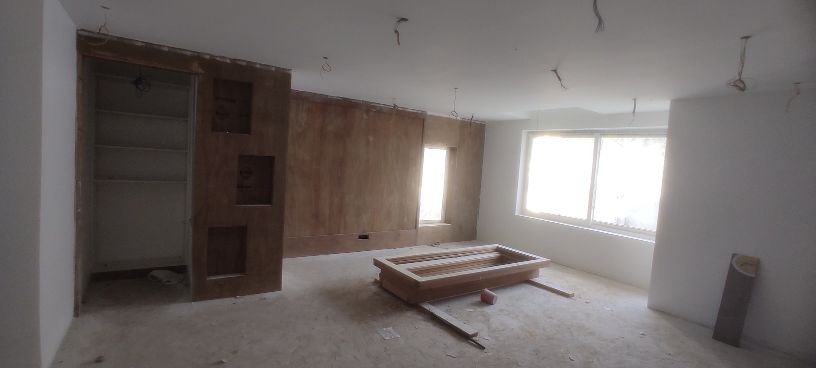

- mock up flat – -100% completed
Tower 2
- RCC for slab – BF2-9th floor roof slab – 100% completed
- 10th roof slab -100% completed,11th floor-30% completed.
- Ceiling plastering: BF1-7th floor -100% completed, BF3-90% completed
- Electrical Wall Chasing: Ground floor -100% completed, 1st floor-2nd floor- 100 % completed ,3rdfloor-70% completed
- Wall Plastering: GF :-30% completed, 1st floor :-85% completed.
- Block Work: GF -75% completed, Basement floor:-70% completed, 1st floor-2nd floor – 100 % completed, 3rd floor -100% completed, 4th floor- 100% completed,5th floor-60% completed
- Yard work: STP RCC -20% completed, Front gate -100% completed, Compound wall-100% completed.

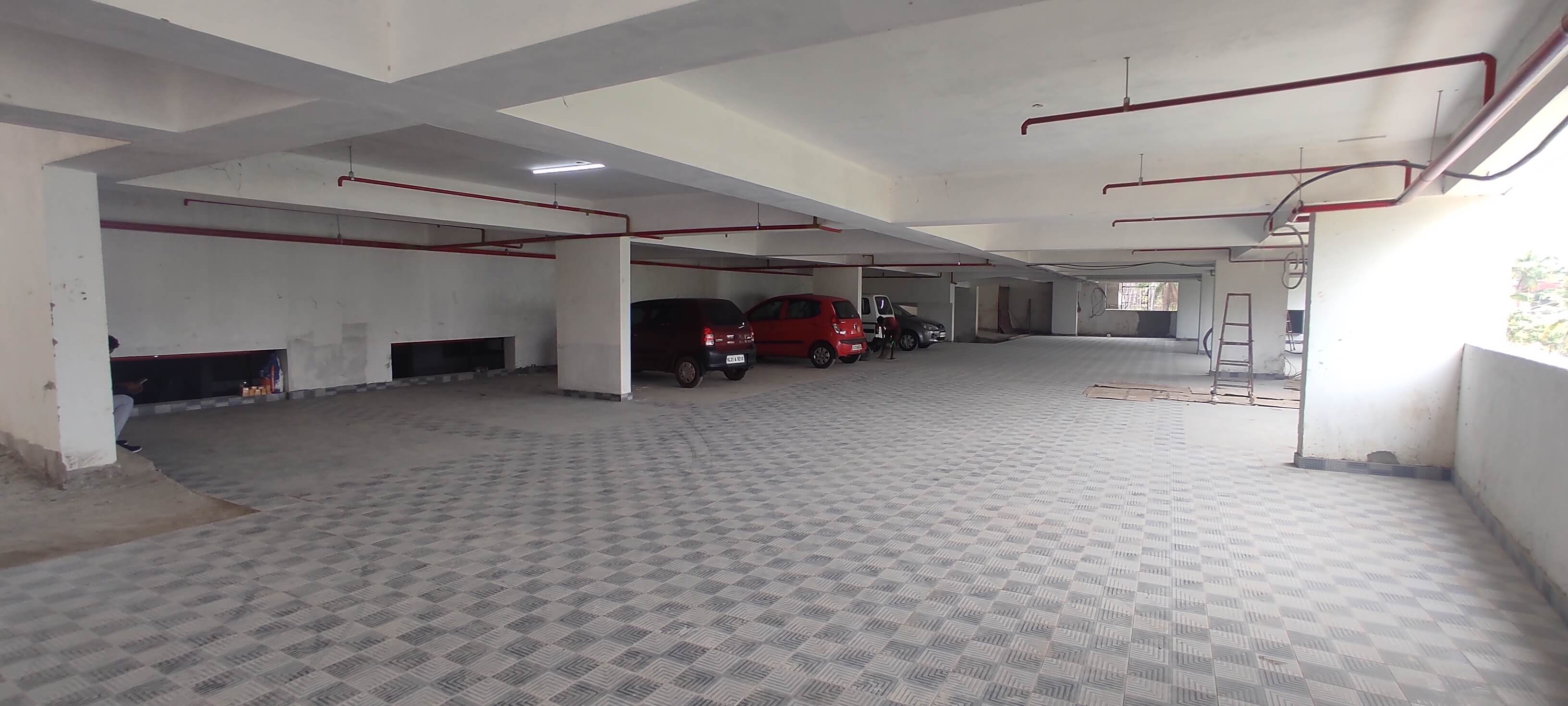

- MLCP: BF1 ceiling & column plastering -100% completed, BF2 ceiling & column plastering -80% completed.
As per the current work status from our site we are targeted to complete the following works by end of July 2020
Tower 1
- RCC for slab – water tank 100% to be completed.
- Block work – ,18th floor-100% to be completed.
- Wall chasing work – 17th floor – 50% to be completed
- Door Frame Fixing -17th floor:-50% to be completed
- Internal wall plastering work – 17th floor-100% to be completed.
- Dadoing of toilets : 11th floor -50% to be completed
- 9th,10th,11th, 12th,13th floor -50% to be completed
- Water Proofing work -16th floor -100% to be completed
- Putty work :- 10th floor -100% to be completed.
- Plumbing work -15th floor-75% to be completed.
- Balcony Handrail work :-upto 18th floor- 100% to be completed.
- 6th ,9th,10th floor- 100% to be completed
- Fixing of door shutters -1st Floor -50% to be completed,3rd floor :-30% to be completed,5th floor :-30% to be completed.
- 13th floor- 75% to be completed.
Tower 2
- RCC for slab -9th roof slab -100% to be completed.
- Ceiling plastering: 2nd floor -100% to be completed, 3rd floor -100% to be completed, 4th floor -100% to be completed, 5th floor -100% to be completed, 6th floor -100% to be completed
- Block Work: 1st floor 100% to be completed

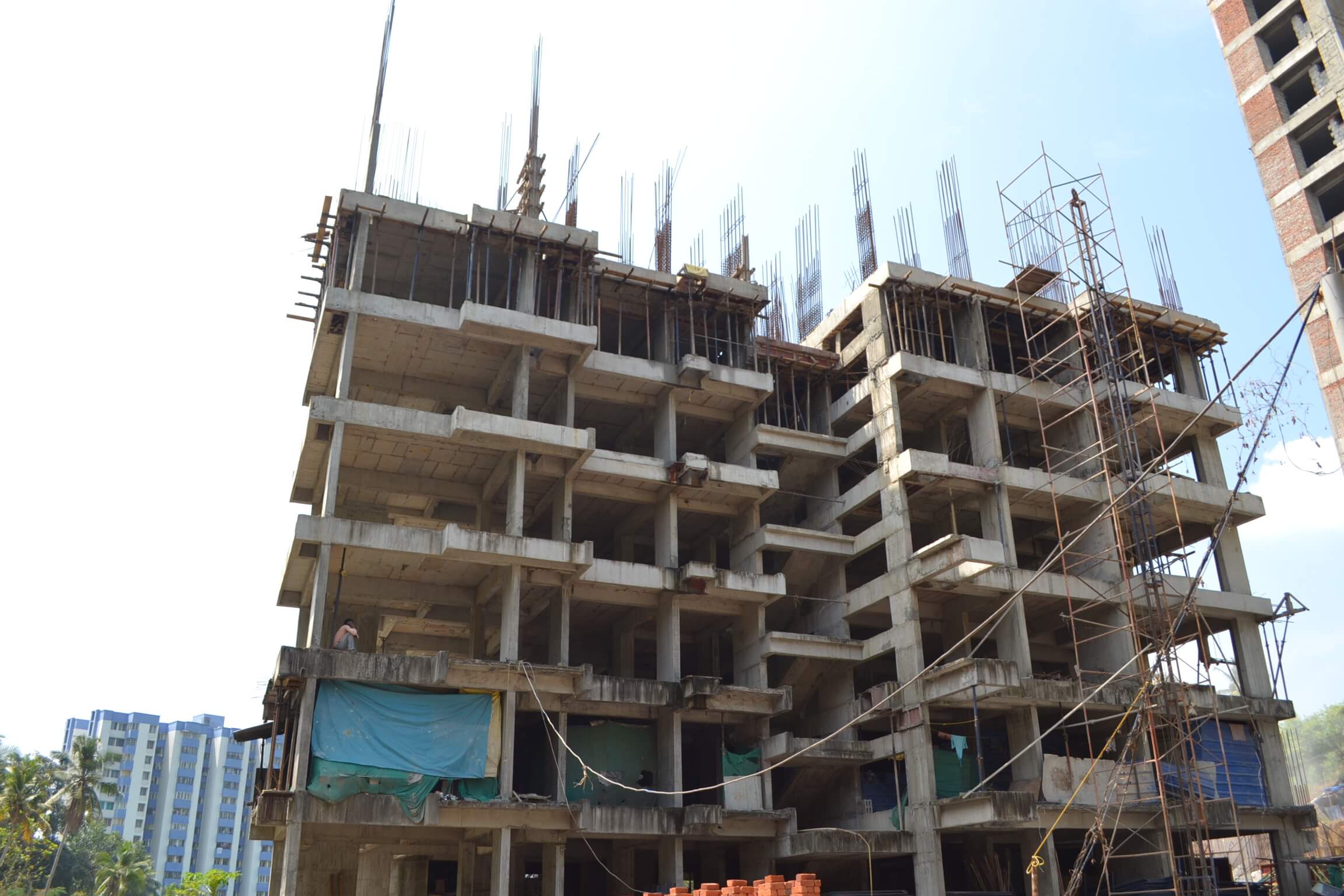

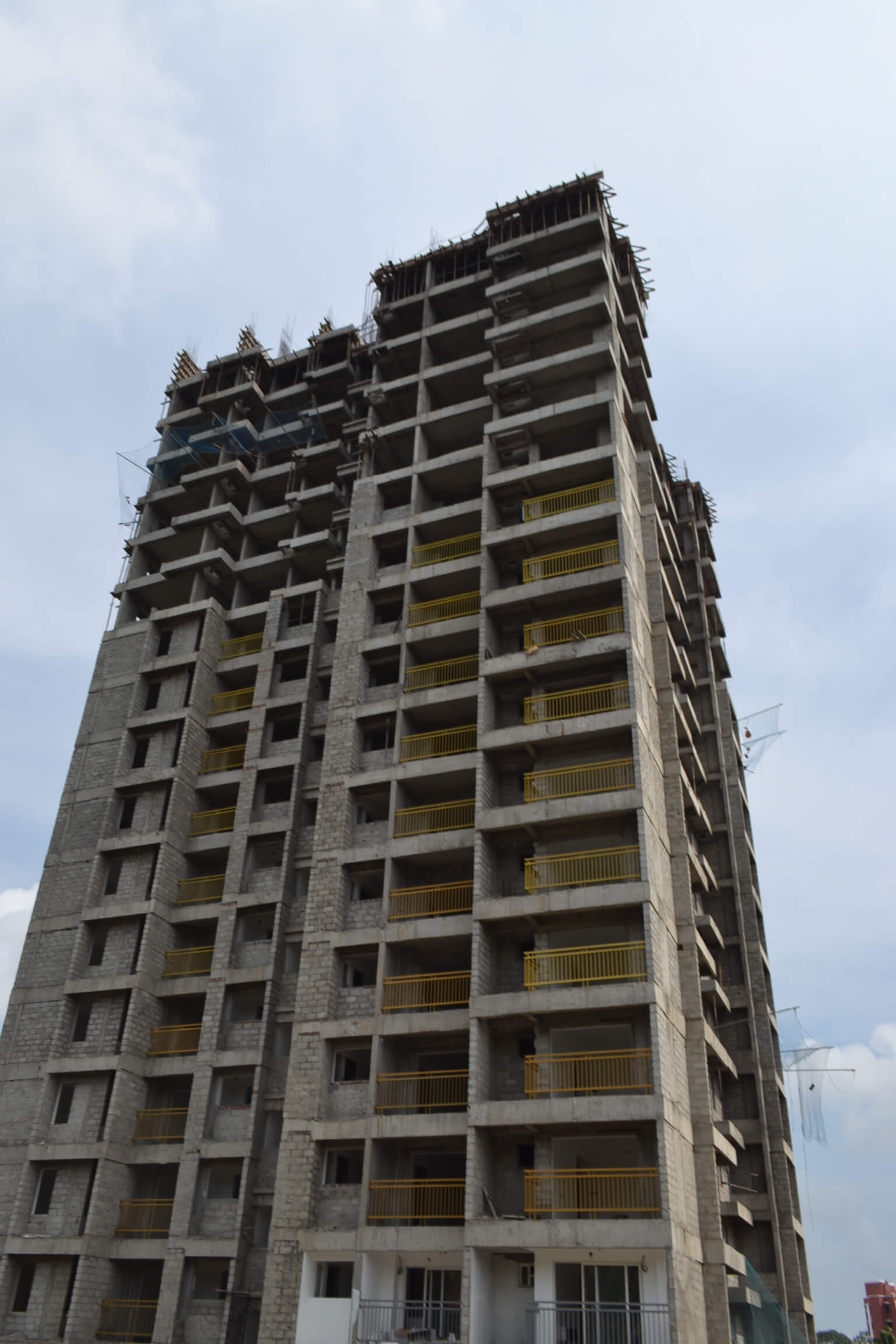

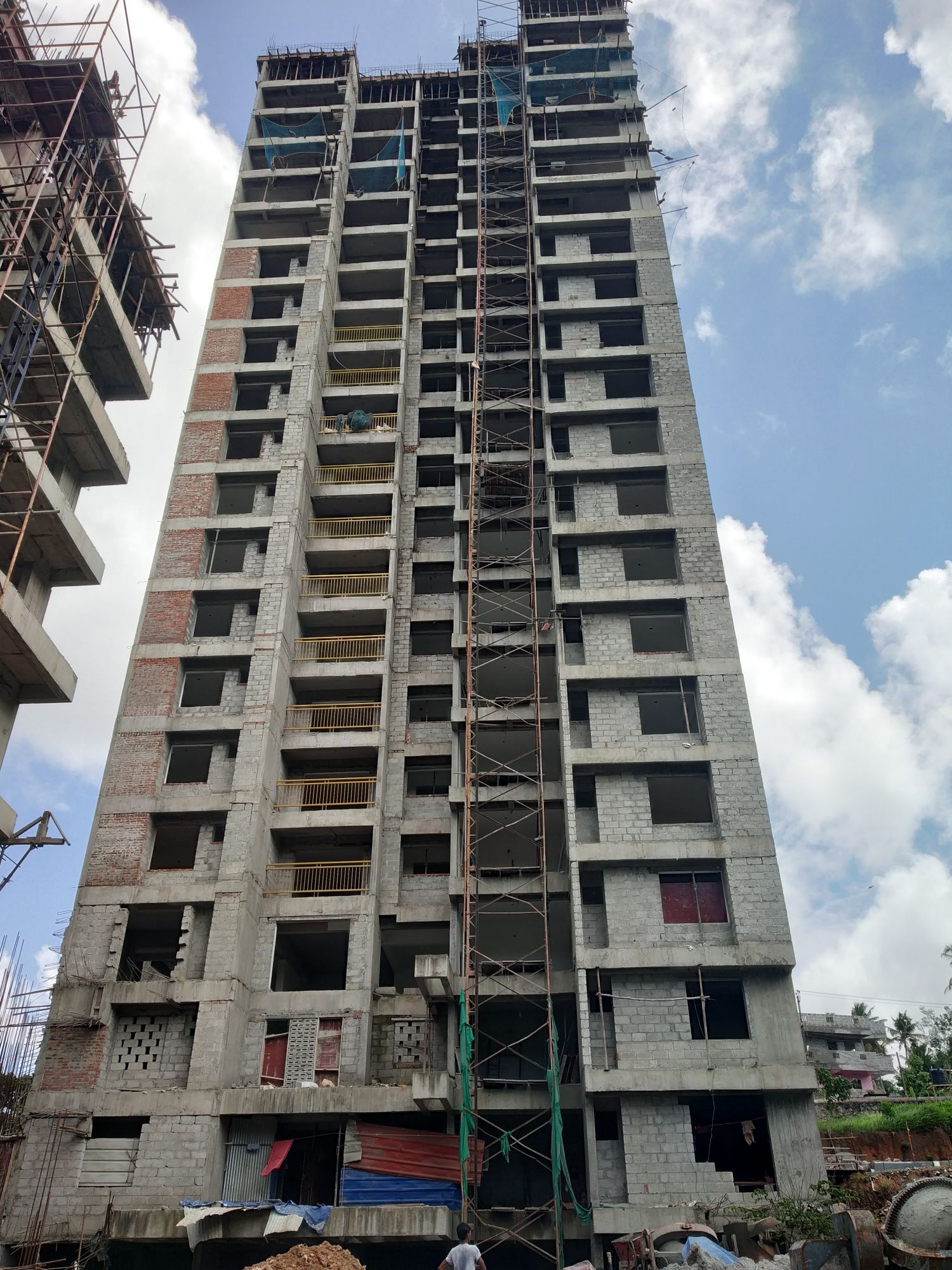

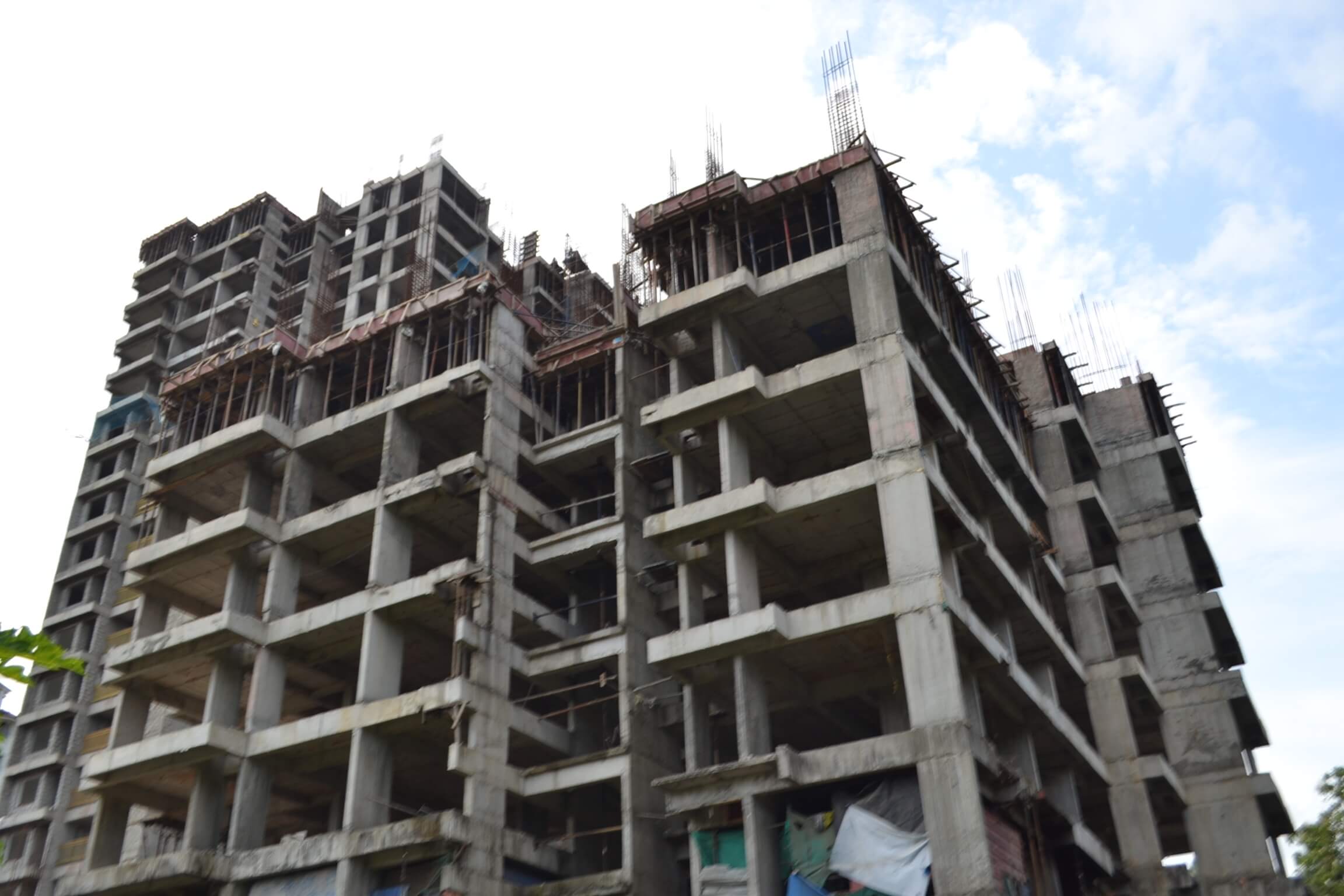

Work status as on 11.06.2020, we have completed the following
Tower 1

- RCC for slab -18th floor -100%completed,19 th floor-100% completed

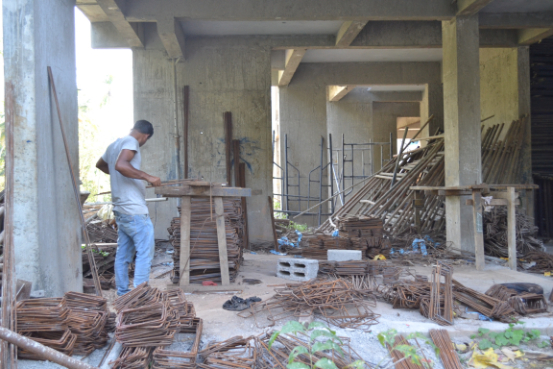

- Block work – BF2-90% completed,BF1,(1-16 th floor )-100%completed, 17th, floor-100% completed, 18th floor :-50% completed.
- Ceiling Plastering work -(BF1- 17th floor -) 100% completed,18 th floor -100% completed.
- Wall chasing work -BF1- 16th floor – 100% completed.
- Door Frame Fixing -BF1-90% Completed,1-16 th -100% completed.
- Internal wall plastering work -upto 16th floor – 100% completed, 17th floor :-60% completed.
- Dadoing of toilets :GF -10th floor-100% completed.
- Dadoing of kitchen walls :GF – 50% completed,1st floor-6th floor-100% completed, 7th floor:-50% completed.
- Wire pulling : GF -30%,1st and 3 rd,5 th ,7 th -90%,2,4,6,8,9,10th -25% completed
- Water Proofing work – Upto 15th floor- 100% completed.
- Putty work – upto 9th floor :-100% completed.
- Plumbing work – upto 13th floor- 100% completed,14th floor-100% completed,15th ffloor- 25% completed.
- Grills /Balcony Handrail work -1 st floor -65% completed,2-9th floor -80% completed,10th-12th floor-60%completed,13th-17thfloor-50% completed,18 th -40% completed
- Flooring and skirting ,, -GF-25% Completed ,1st,floor :-80% completed,3 rd floor:-100% completed. ,5 th floor:-100% completd ,7th floor-100% completed.
- Fixing of door shutters -1st Floor -25%completed
- Fire Fighting work :GF-12th floor-75% completed
- First and second coat painting ,CP and sanitary fittings ,DB Dressing ,Switch Fixing ,Final cleaning and pointing -First floor -25% completed.
- Aluminium windows & ventilators-GF,FF-25% completed
- mock up flat – 100% completed
Tower 2
- RCC for slab – BF2-7th floor roof slab – 100% completed
- 8th floor roof slab – 100% completed, 9th floor-50% completed.
- Ceiling plastering: 1st floor -90% completed, 2nd floor -90% completed, 3rd floor -90% completed, 4th floor -50% completed, 5th floor -50% completed
As per the current work status from our site we are targeted to complete the following works by end of September 2019
Tower 1
- RCC for slab -19 th floor-50% to be completed
- Block work – 13 th floor -100% ,14 th -50% to be completed
- Ceiling Plastering work – 14th floor – 100%,15 th-50% to be completed
- Wall chasing work – 12th floor – 100% ,13 thfloor -50% to be completed
- Door Frame Fixing -12 th floor (100% to be completed)
- Internal wall plastering work – 10 th ,11 th ,12 th -100% to be completed.
- Dadoing of toilets :GF -90% Completed,First floor -50% completed, 2-5 th -80% to be completed .dadoing of kitchen walls:Ground floor -30% completed,FF-35 % to be completed.
- Wire pulling : 2-6 th floor -30% to be completed.
- Water Proofing work – GF-11 th floor -100% to be completed
- Putty work – GF-7 th -100% to be completed.
- Plumbing work-GF-10 th floor -100% ,11 th floor -75% to be completed
- Balcony Handrail work -10th floor -50% to be completed
- Aluminium Fabrication work -GF,1F-25% to be completed .Fixing of door shutters -GF-11 th Floor -65% to be completed .Grills& Handrails -1F -65%,2-10 th floor -50% to be completed
Tower 2
- RCC for slab -7th roof slab -100% to be completed.

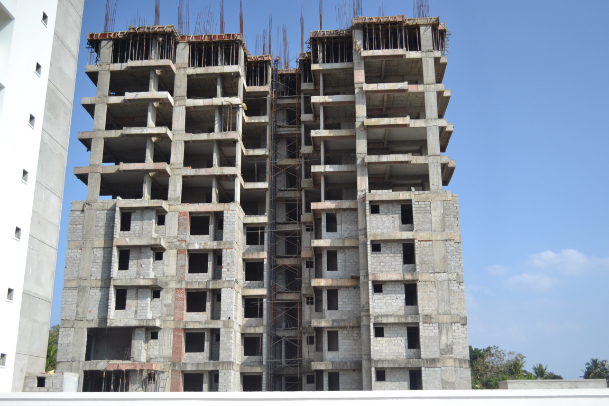

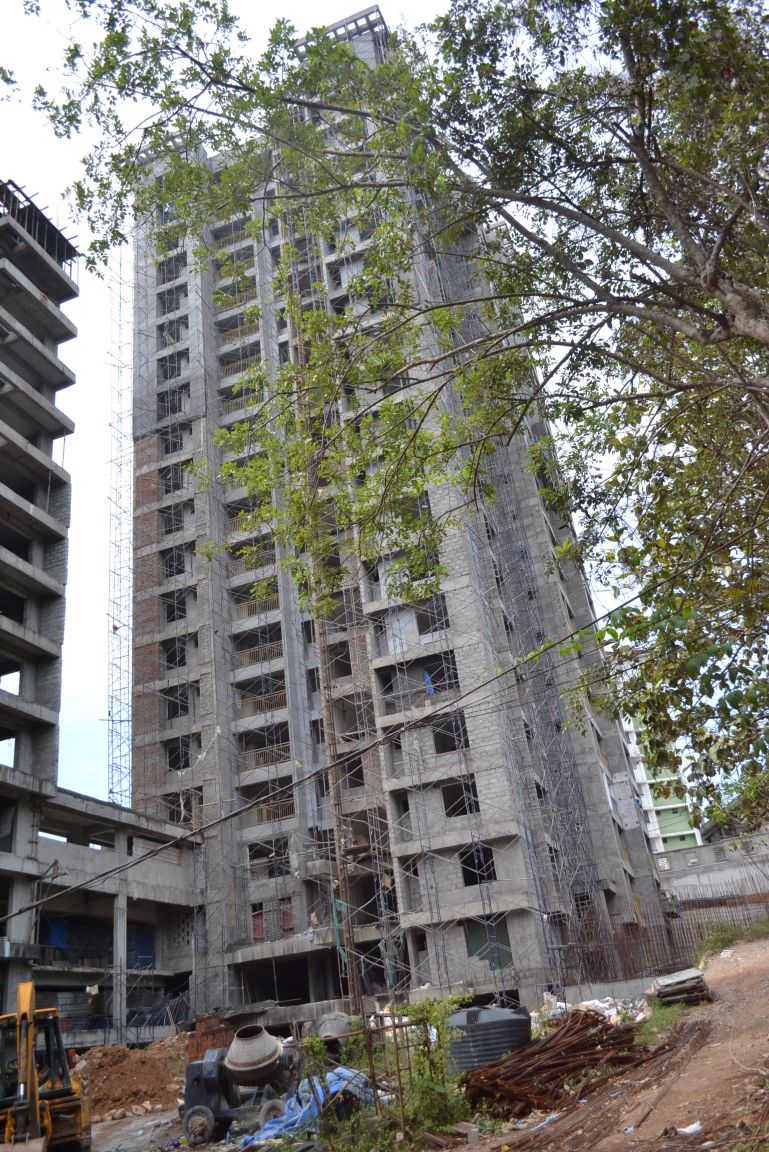

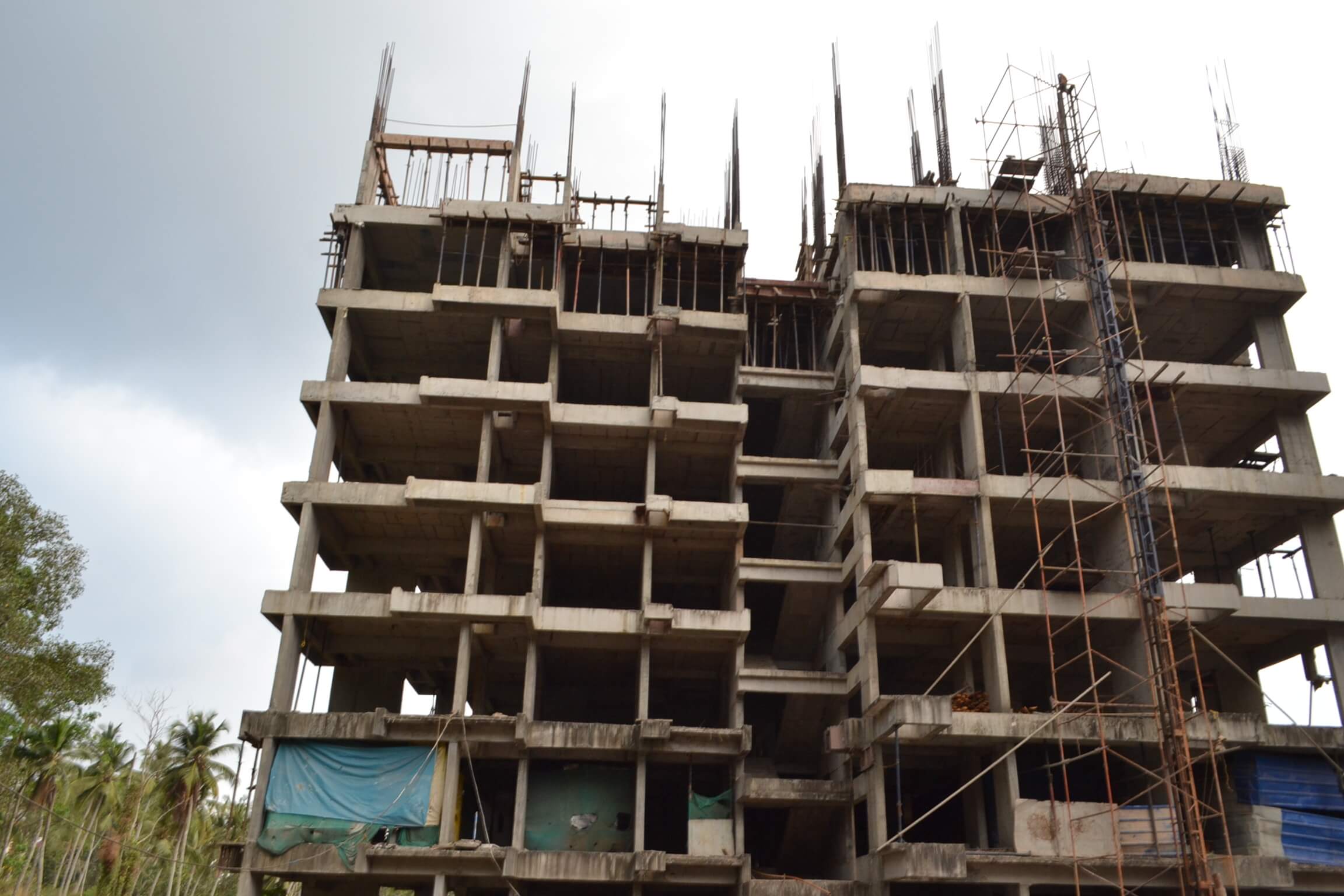

Work status as on 05.09.2019, we have completed the following
Tower 1

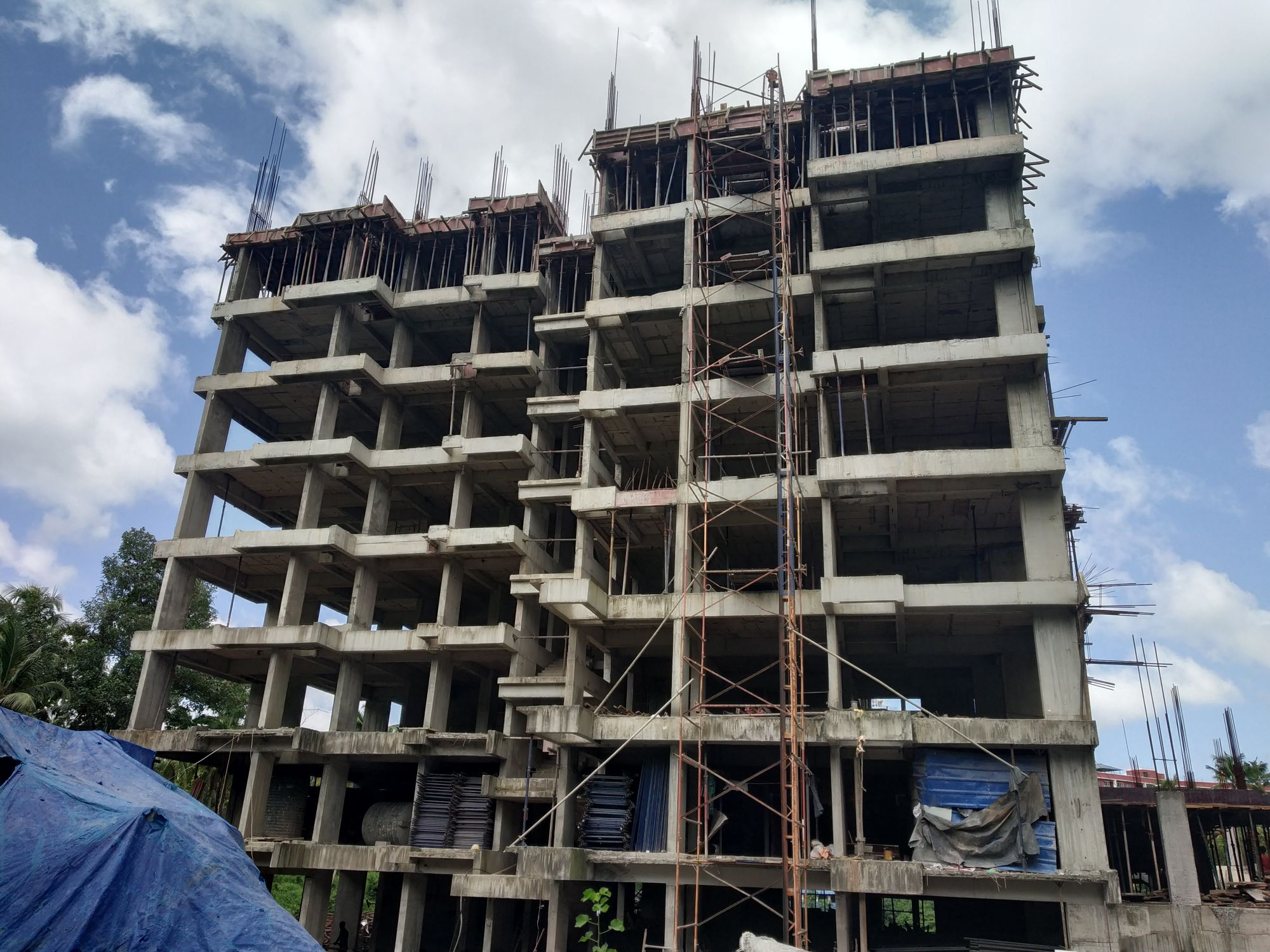

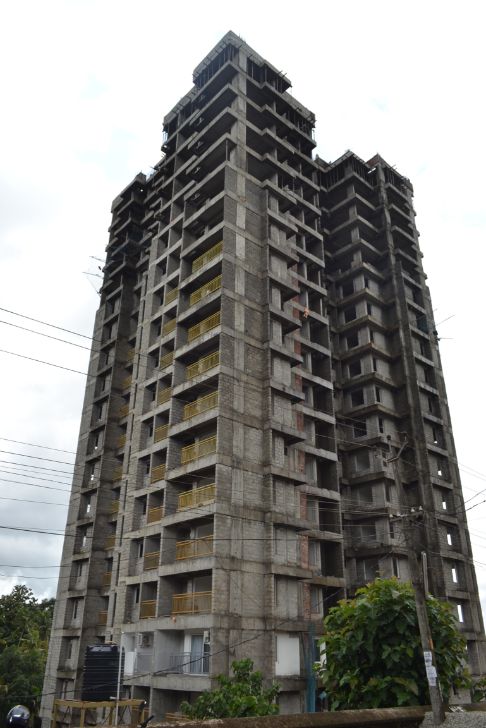

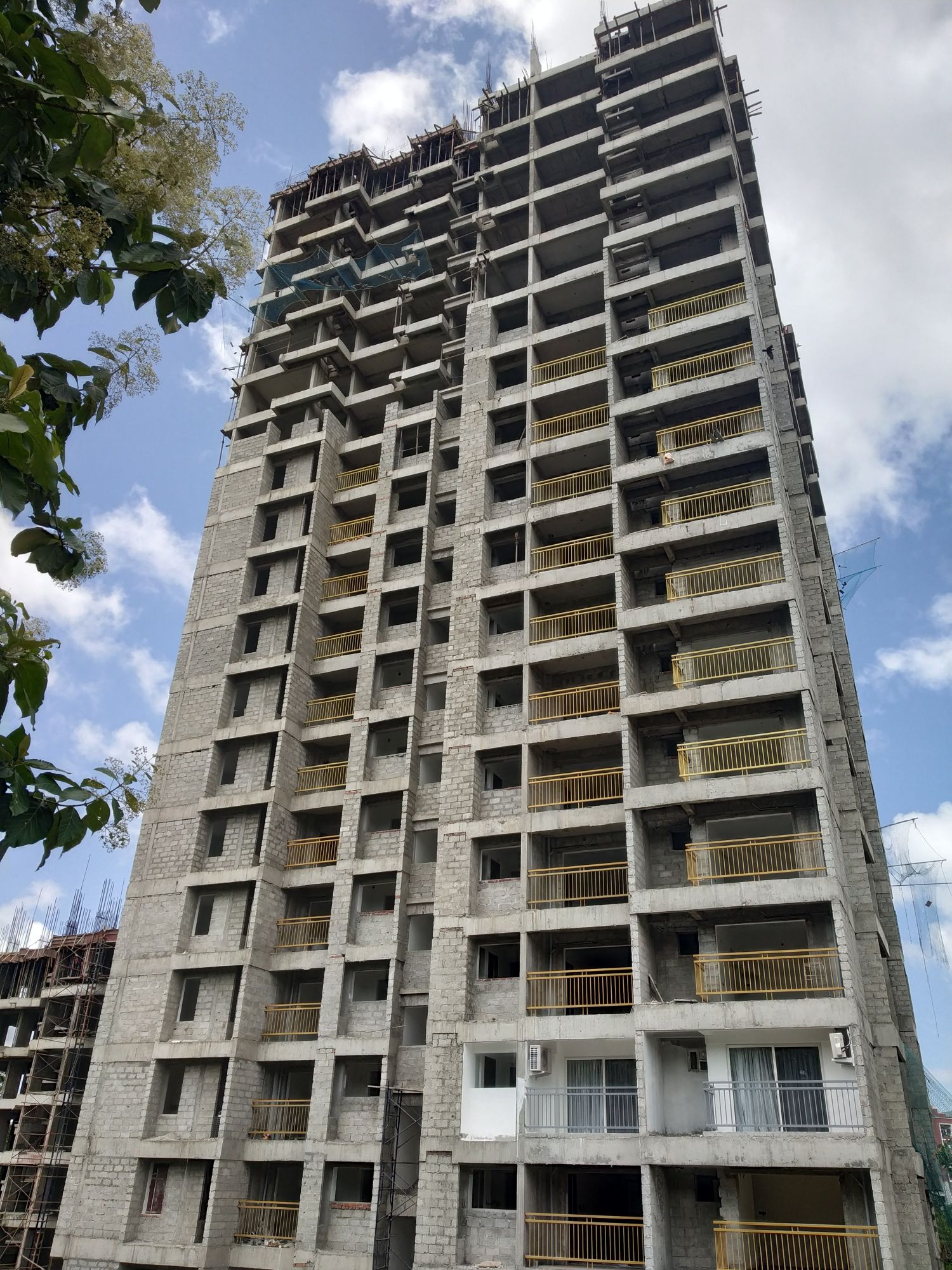

- RCC for slab -18th floor -100%completed,19 th floor-20% completed
- Block work – BF2-90% completed,BF1,(1-11 th floor )-100% Completed,12 th floor-100% completed,13 th -30% completed
- Ceiling Plastering work -(BF1- 12th floor -) 100% completed,13 -90% completed
- Wall chasing work -BF1- -9th floor – 100% completed,10 th floor -100% completed,11 th floor-80% to be completed,12 th-40% completed .
- Door Frame Fixing -BF1-90% Completed,1-11 th -100% completed.
- Internal wall plastering work -BF1 (70% completed); GF, 1st-6 th floor (100% completed),7th floor -90% completed,8 th-90%,9 th-100% completed ,10th -70% completed.
- Dadoing of toilets :GF -50% Completed,First floor to fourth-50% completed, dadoing of kitchen walls:1 st floor -25% completed
- Wire pulling : Ground to fourth floor -10% completed,
- Water Proofing work – BF1-30% Completed,GF to 8th floor – 100% completed;8 th -50% completed,9 th -60% ,10 th -50% completed .
- Putty work – BF1-70% Completed,GF- 4 th floor -100% completed,5 th&6 th -90% completed.
- Plumbing work -(GF-7 th floor) -100% completed,8-9 th floor -50% completed.
- Balcony Handrail work -1 st floor -65% completed,2-9 th floor -50% completed.
- Flooring and skirting ,Aluminum fabrication work ,door shutter fixing -GF-10% Completed ,1 st floor-25% completed
- Fire Fighting work :-1 st floor-15% completed
- First and second coat painting ,CP and sanitary fittings ,DB Dressing ,Switch Fixing ,Final cleaning and pointing -First floor -25% completed.
- mock up flat -ceiling plastering ,block and brick masonry ,door frame fixing ,electrical chasing ,plumbing work ,wall chasing ,wall plastering ,dadoing of toilets ,kitchen walls ,application of putty on wall sand ceiling ,water proofing ,flooring and skirting ,aluminium doors and window fixing ,door shutter fixing ,grills and handrails fixing ,wire pulling -100% completed
Tower 2

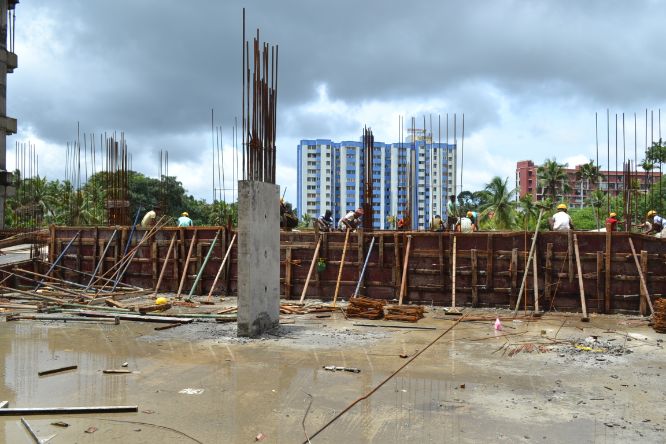

- Column work – BF1 – 100% completed
- Column rising work – 1st floor – 100% completed
- Column rising work – 2nd floor -100% completed
- Column rising work – 3rd floor -100% completed
- Column rising work – 4th floor -100% completed
- Column rising work – 5th floor -100% completed
- RCC for slab – BF2 roof slab – 100% completed
- RCC for slab – BF1 roof slab – 100% completed
- RCC for slab – First floor roof slab – 100% completed
- RCC for slab -Second floor roof slab -100% completed
- RCC for slab -Third floor roof slab -100% completed
- RCC for slab -fourth roof slab -100% completed
- RCC for slab -fifth roof slab 100% completed
- RCC for slab -6th roof slab -25% to be completed.
As per the current work status from our site we are targeted to complete the following works by end of August 2019
Tower 1
- Ceiling Plastering work – 14th floor – 50% to be completed
- Wall chasing work – 11th floor – 100% completed
- Door Frame Fixing -11 th floor (100% to be completed)
- Internal wall plastering work – 9 th floor -100 %,10 th -75 %to be completed
- Dadoing of toilets :GF -90% Completed,First floor -50% completed, dadoing of kitchen walls:Ground floor -30% completed,FF-35 % to be completed.
- Wire pulling : 2-6 th floor -30% completed.
- Water Proofing work – GF-10 th -100% to be completed
- Putty work – GF-7 th -100% to be completed.
- Plumbing work-GF-8 th floor 100% to be completed.
- Balcony Handrail work -10th floor -50% to be completed
Tower 2
- RCC for slab -fifth roof slab -75% to be completed,6th roof slab -25% to be completed.

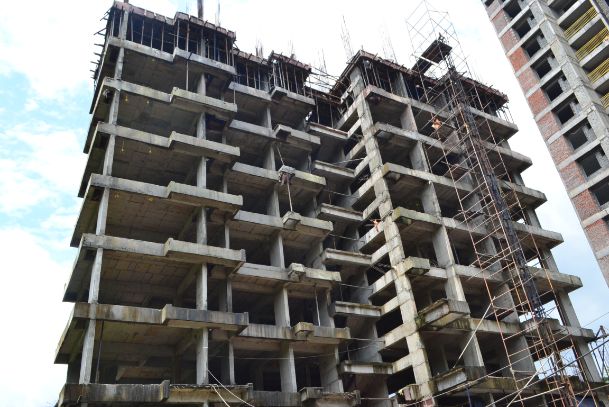

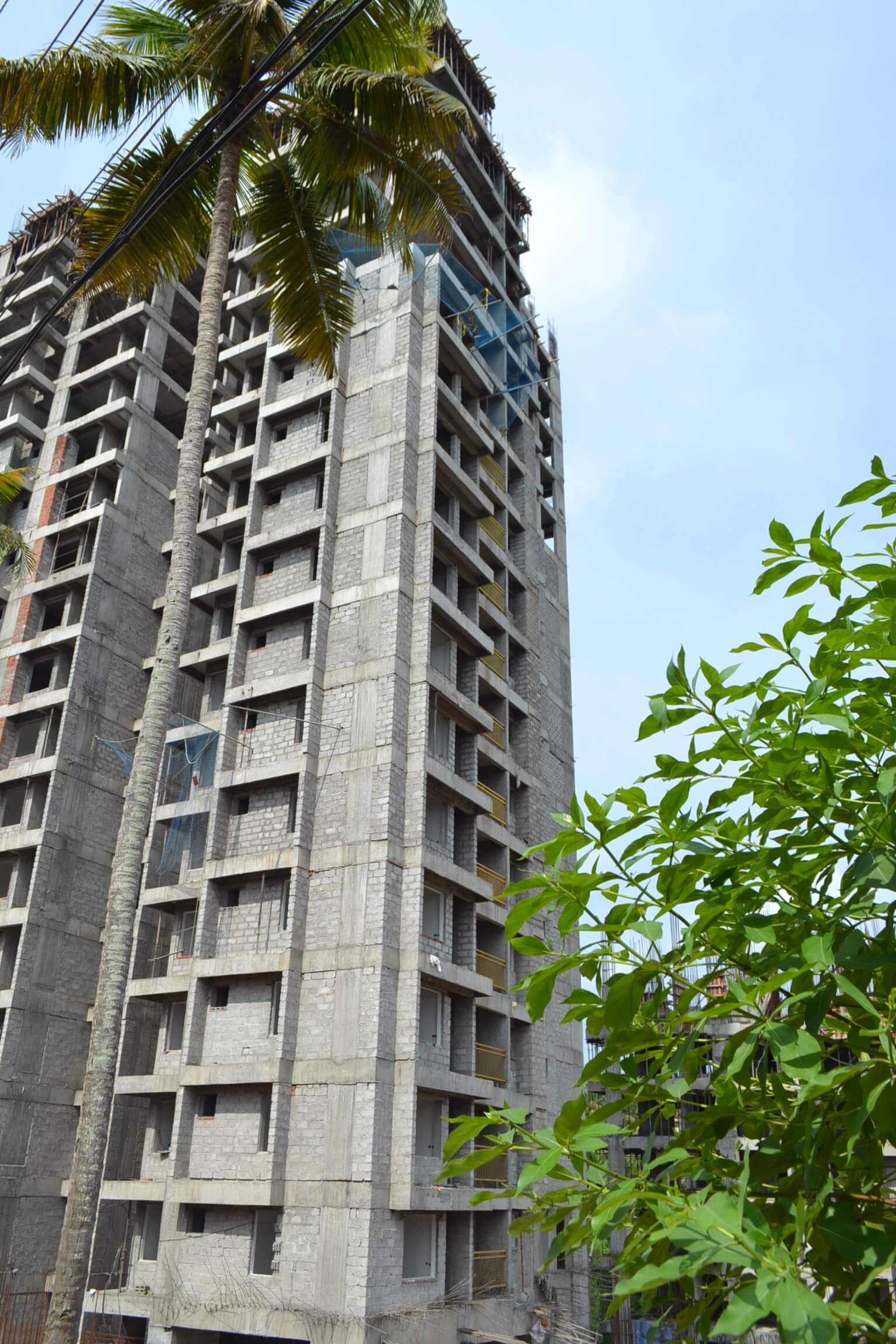

Work status as on 05.08.2019, we have completed the following
Tower 1

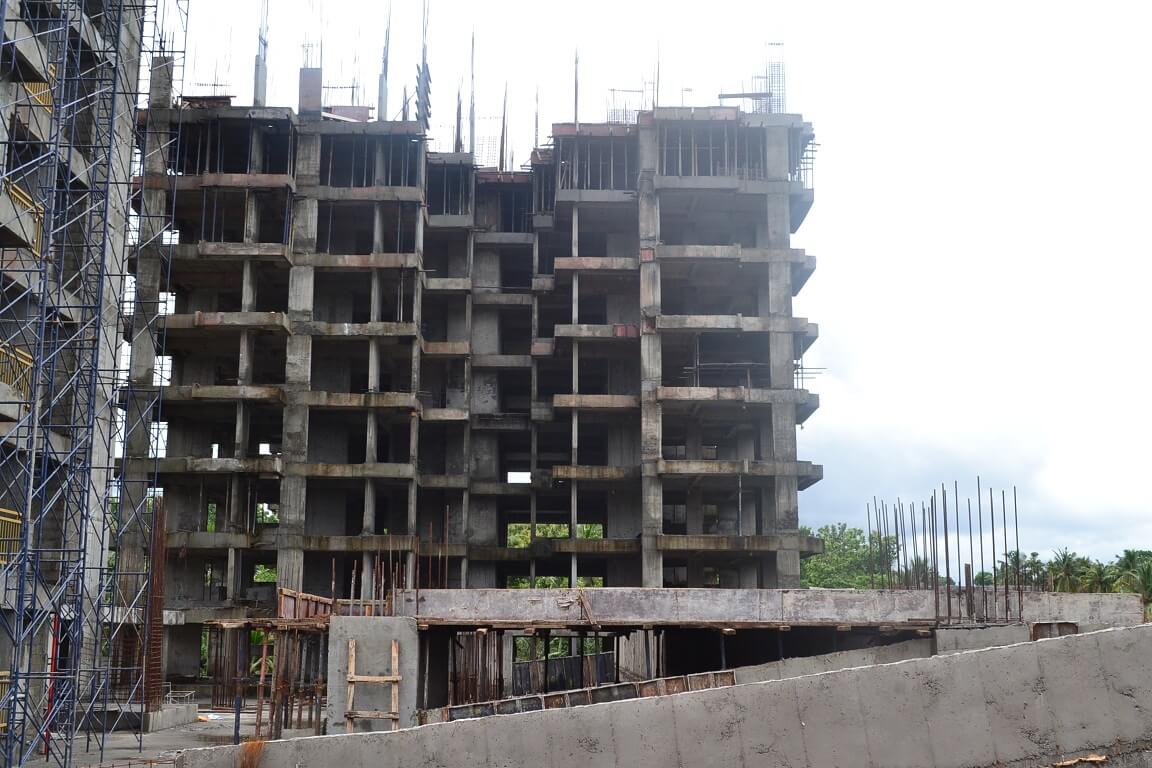

- RCC for slab -18th floor -90%completed
- Block work – BF2-90% completed,BF1,(1-11 th floor )-100% Completed,12 th floor-80% completed.
- Ceiling Plastering work -(BF1- 12th floor -) 100% completed,13 -45% completed
- Wall chasing work -BF1- -9th floor – 100% completed,10 th floor -80% completed,11 th floor-50% to be completed.
- Door Frame Fixing -BF1-90% Completed,1-10 th -100% completed.
- Internal wall plastering work -BF1 (70% completed); GF, 1st-6 th floor (100% completed),7th floor -90% completed,8 th-90%,9 th-90% completed .
- Dadoing of toilets :GF -35% Completed,First floor to fourth-25% completed, dadoing of kitchen walls:1 st floor -25% completed
- Wire pulling : Ground to fourth floor -10% completed,
- Water Proofing work – BF1-30% Completed,GF to 7 th floor – 100% completed;8 th -50% completed.
- Putty work – BF1-70% Completed,GF- 4 th floor -100% completed,5 th&6 th -90% completed.
- Plumbing work -(GF-5 th floor) -100% completed,6 th -50% completed.
- Balcony Handrail work -1 st floor -65% completed,2-9 th floor -50% completed.
- Flooring and skirting ,Aluminum fabrication work ,door shutter fixing -GF-10% Completed ,1 st floor-25% completed
- Fire Fighting work :-1 st floor-15% completed
- First and second coat painting ,CP and sanitary fittings ,DB Dressing ,Switch Fixing ,Final cleaning and pointing -First floor -25% completed.
- mock up flat -ceiling plastering ,block and brick masonry ,door frame fixing ,electrical chasing ,plumbing work ,wall chasing ,wall plastering ,dadoing of toilets ,kitchen walls ,application of putty on wall sand ceiling ,water proofing ,flooring and skirting ,aluminium doors and window fixing ,door shutter fixing ,grills and handrails fixing ,wire pulling -100% completed
Tower 2
- Column work – BF1 – 100% completed
- Column rising work – 1st floor – 100% completed
- Column rising work – 2nd floor -100% completed
- Column rising work – 3rd floor -100% completed
- Column rising work – 4th floor -100% completed
- RCC for slab – BF2 roof slab – 100% completed
- RCC for slab – BF1 roof slab – 100% completed
- RCC for slab – First floor roof slab – 100% completed
- RCC for slab -Second floor roof slab -100% completed
- RCC for slab -Third floor roof slab -100% completed
- RCC for slab -fourth roof slab -100% completed
- RCC for slab -fifth roof slab -25% completed
As per the current work status from our site we are targeted to complete the following works by end of July 2019
Tower 1
- Block work -12 th floor -50% to be completed
- Ceiling Plastering work – 14th floor – 50% to be completed
- Wall chasing work – 11th floor – 100% completed
- Door Frame Fixing -11 th floor (100% to be completed)
- Internal wall plastering work – 9 th floor 100 %to be completed
- Dadoing of toilets :GF -90% Completed,First floor -50% completed, dadoing of kitchen walls:Ground floor -30% completed,FF-25 % to be completed.
- Wire pulling : 2-6 th floor -30% completed.
- Water Proofing work – 7 th & 8 th floor -100% to be completed,9 th floor -50% to be completed.
- Putty work – GF-7 th -100% to be completed.
- Plumbing work-6 th floor -100% to be completed,7 th floor -75% to be completed
- Balcony Handrail work -10th floor -50% to be completed
Tower 2
- RCC for slab -fourth roof slab -100% to be completed,5 th roof slab -50% to be completed.

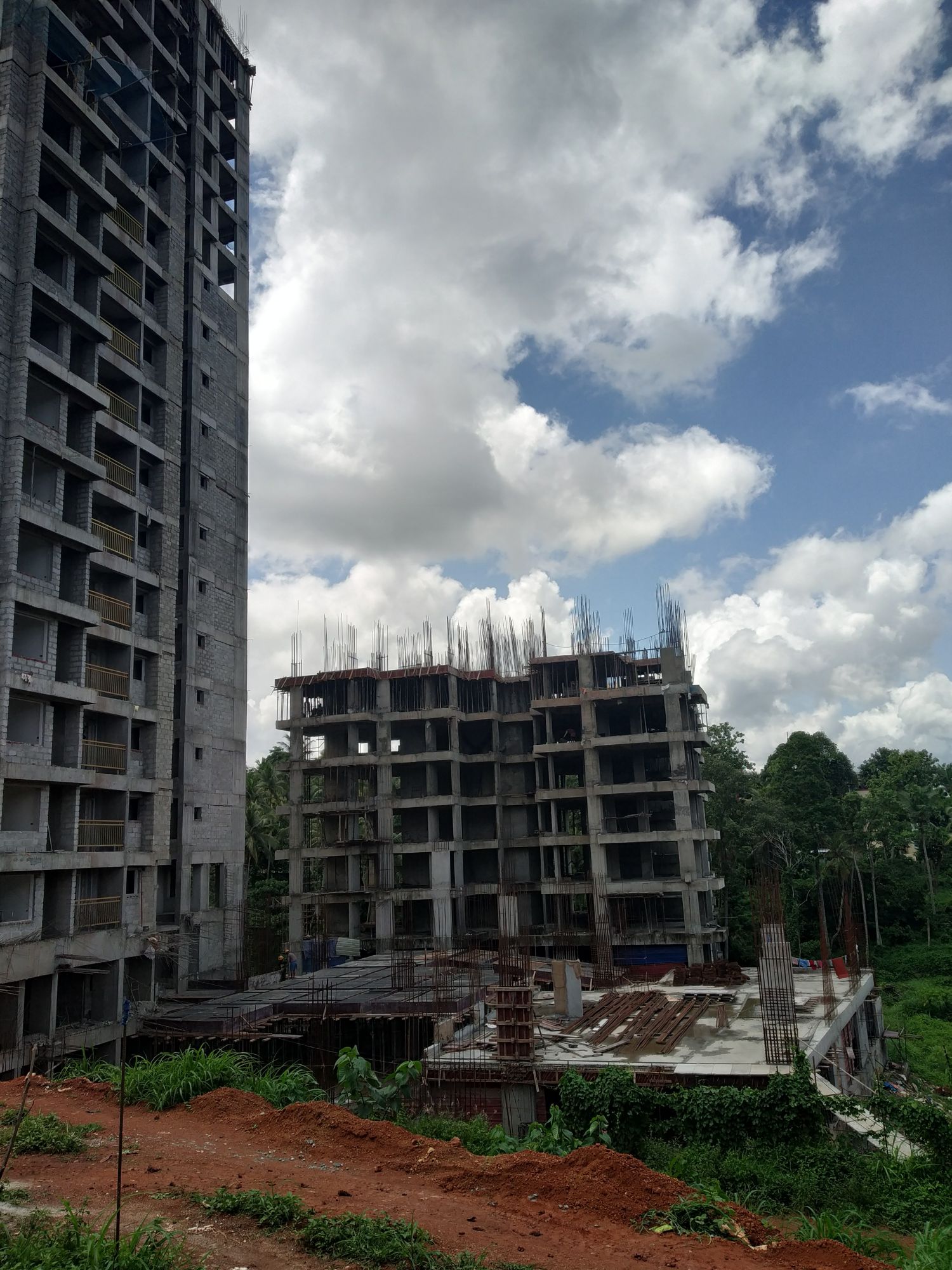

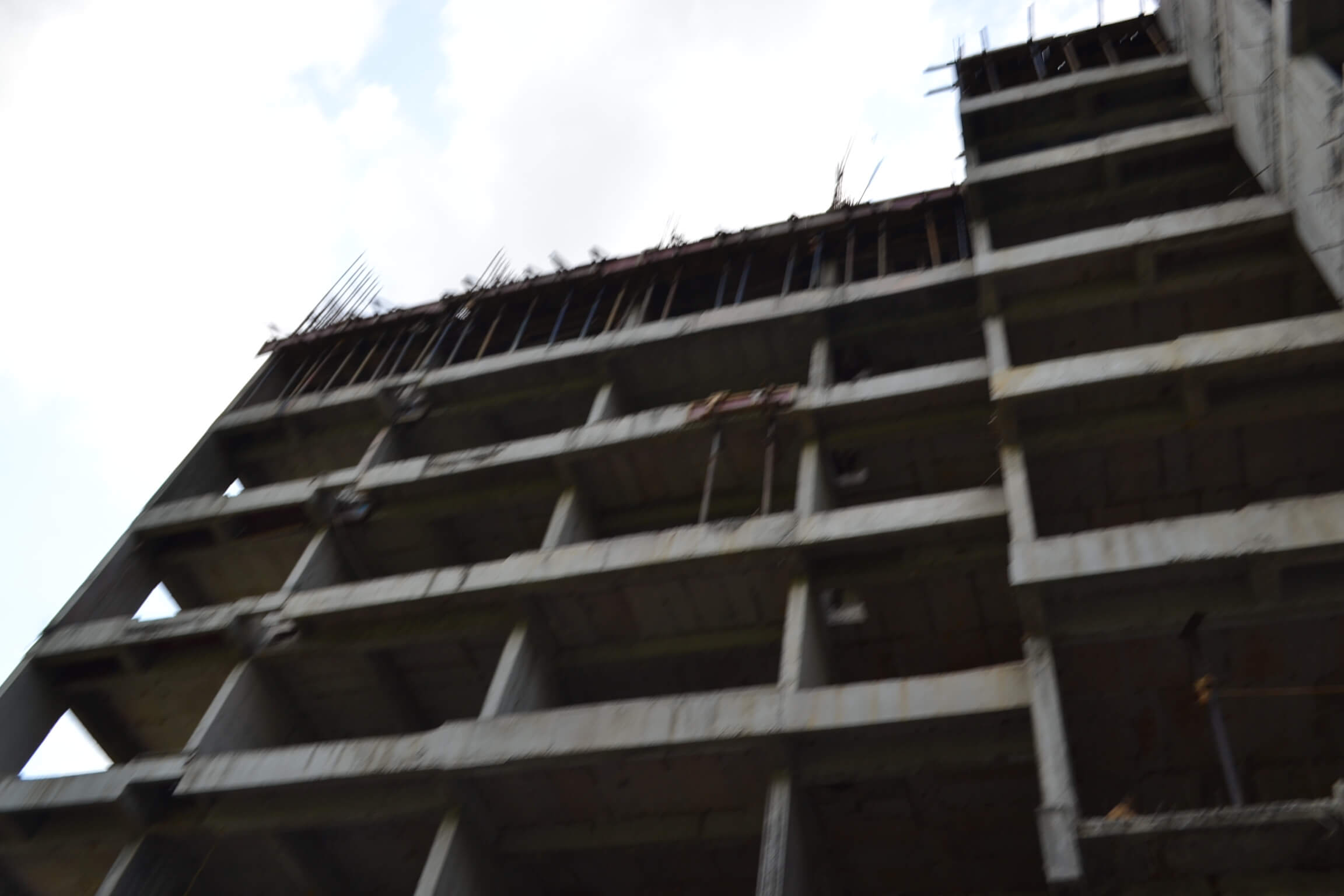

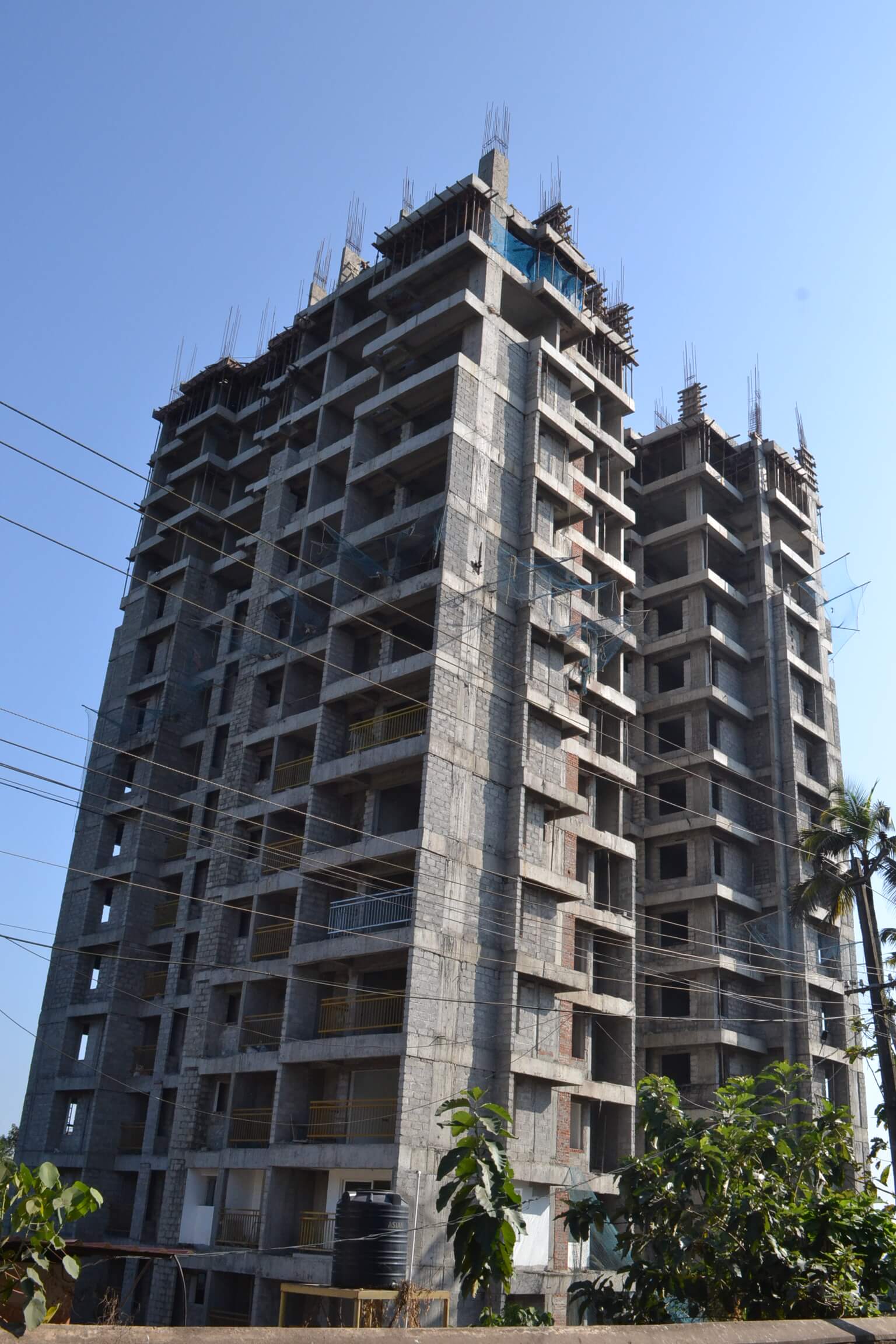

Work status as on 06.07.2019, we have completed the following
Tower 1
- Column work – 18 floor – 100% completed
- RCC for slab -18th floor -50%completed
- Block work – BF2-90% completed,BF1,(1-10 th floor )-100% Completed,11th floor -70% completed
- Ceiling Plastering work -(BF1- 12th floor -) 100% completed,13 -45% completed
- Wall chasing work -BF1- -9th floor – 100% completed,10 th floor -80% completed,11 th floor-10% to be completed.
- Door Frame Fixing -BF1-90% Completed,1-10 th -100% completed.
- Internal wall plastering work -BF1 (70% completed); GF, 1st-6 th floor (100% completed),7th floor -90% completed,8 th-90%,9 th-50% completed .
- Dadoing of toilets :GF -35% Completed,First floor -25% completed, dadoing of kitchen walls:1 st floor -25% completed
- Wire pulling : Ground to Third floor -10% completed,
- Water Proofing work – BF1-30% Completed,GF – 100% completed; 1st-3rd floor – 100% completed,4-5th floor -100% completed,6 th -50% completed.
- Putty work – BF1-70% Completed,GF- 4 th floor -100% completed,5 th&6 th -90% completed.
- Plumbing work -(GF-3rd floor) -100% completed,4 th -5 th floor -50% completed.
- Balcony Handrail work -1 st floor -65% completed,2-9 th floor -50% completed.
- Flooring and skirting ,Aluminum fabrication work ,door shutter fixing -GF-10% Completed ,1 st floor-25% completed
- Fire Fighting work :-1 st floor-15% completed
- First and second coat painting ,CP and sanitary fittings ,DB Dressing ,Switch Fixing ,Final cleaning and pointing -First floor -25% completed.
- mock up flat -ceiling plastering ,block and brick masonry ,door frame fixing ,electrical chasing ,plumbing work ,wall chasing ,wall plastering ,dadoing of toilets ,kitchen walls ,application of putty on wall sand ceiling ,water proofing ,flooring and skirting ,aluminium doors and window fixing ,door shutter fixing ,grills and handrails fixing (100% completed),wire pulling (80% completed)
Tower 2
- Column work – BF1 – 100% completed
- Column rising work – 1st floor – 100% completed
- Column rising work – 2nd floor -100% completed
- Column rising work – 3rd floor -100% completed
- Column rising work – 4th floor -100% completed
- RCC for slab – BF2 roof slab – 100% completed
- RCC for slab – BF1 roof slab – 100% completed
- RCC for slab – First floor roof slab – 100% completed
- RCC for slab -Second floor roof slab -100% completed
- RCC for slab -Third floor roof slab -100% completed
- RCC for slab -fourth roof slab -75% completed
As per the current work status from our site we are targeted to complete the following works by end of June 2019
Tower 1
- Block work -12 th floor -50% to be completed
- Ceiling Plastering work – 13th floor – 100% to be completed
- Wall chasing work – 10th floor – 100% completed
- Door Frame Fixing -11 th floor (13% to be completed)
- Internal wall plastering work – 7 th ,8 th floor 100 %to be completed
- Water Proofing work – 6 th floor -100% to be completed
- Putty work – 5 th&6 th -100% to be completed.
- Plumbing work :4 th floor -100% to be completed,5 th floor -40% to be completed
- Balcony Handrail work -10th floor -50% to be completed
Tower 2
- Column rising work – 4th floor -100% completed
- RCC for slab -fourth roof slab -100% completed
Work status as on 06.06.2019, we have completed the following
Tower 1
- Column work – 16 floor – 100% completed
- RCC for slab -17 th floor -100%completed
- Block work – BF2-90% completed,BF1(1-9)-100% Completed,10 th floor -90% completed,11 th floor -70% completed.
- Ceiling Plastering work -(BF1- 12th floor -) 100% completed,13 -45% completed
- Wall chasing work -BF1- -9th floor – 100% completed,10 th floor -40% completed.
- Door Frame Fixing -BF1-90% Completed,GF-4 th floor -100% completed,5-10 th floor (13% completed)
- Internal wall plastering work -BF1 (70% completed); GF, 1st-6 th floor (100% completed),7th floor -90% completed,8 th-30%,9 th-50% completed.
- Dadoing of toilets :GF -15% Completed,First floor -25% completed, dadaoing of kitchen walls:1 st floor -25% completed
- Wire pulling : 1st-floor -10% completed
- Water Proofing work – BF1-30% Completed,GF – 100% completed; 1st-3rd floor – 100% completed,4-5th floor -100% completed,6 th -50% completed.
- Putty work – BF1-70% Completed,GF- 4 th floor -100% completed,5 th&6 th -90% completed.
- Plumbing work -(GF-2nd floor) -100% completed,3rd floor -90% completed,4 th floor -50% completed.
- Balcony Handrail work -1 st floor -65% completed,2-9 th floor -50% completed.
- Flooring and skirting ,Aluminum fabrication work ,door shutter fixing –1 st floor-25% completed
- Fire Fighting work :-1 st floor-15% completed
- mock up flat -ceiling plastering ,block and brick masonry ,door frame fixing ,electrical chasing ,plumbing work ,wall chasing ,wall plastering ,dadoing of toilets ,kitchen walls ,application of putty on wall sand ceiling ,water proofing ,flooring and skirting ,aluminium doors and window fixing ,door shutter fixing ,grills and handrails fixing (100% completed),wire pulling (80% completed)
Tower 2
- Column work – BF1 – 100% completed
- Column rising work – 1st floor – 100% completed
- Column rising work – 2nd floor -100% completed
- Column rising work – 3rd floor -100% completed
- Column rising work – 4th floor -75% completed
- RCC for slab – BF2 roof slab – 100% completed
- RCC for slab – BF1 roof slab – 100% completed
- RCC for slab – First floor roof slab – 100% completed
- RCC for slab -Second floor roof slab -100% completed
- RCC for slab -Third floor roof slab -100% completed
- RCC for slab -fourth roof slab -60% completed
As per the current work status from our site we are targeted to complete the following works by end of May 2019
Tower 1
- Column work – 16th floor – 100% to be completed
- RCC for slab – 17th floor – 100% to be completed
- Block work – 10-th floor -100% to be completed,11 th floor -60% to be completed,12 th floor -50% to be completed
- Ceiling Plastering work – 13th floor – 100% to be completed
- Wall chasing work – 10th floor – 100% completed
- Door Frame Fixing -10-11 th floor (13% to be completed)
- Internal wall plastering work – 8 th floor 100 %to be completed
- Water Proofing work – 4-5th floor -100% to be completed,6 th floor -50% to be completed
- Plumbing work 3rd floor -100% completed,4 th floor -50% completed,5 th floor -20% to be completed
- Balcony Handrail work -up to -10th floor -100% to be completed
Tower 2
- Column rising work – 4th floor -100% completed
- RCC for slab -fourth roof slab -100% completed
Work status as on 06.05.2019, we have completed the following
Tower 1
- Column work – 16 floor – 75% completed
- RCC for slab -17 th floor -50%completed
- Block work – BF2-90% completed,BF1(1-9)-100% Completed,10 th floor -75% completed,11 th floor -70% completed.
- Ceiling Plastering work -(BF1- 12th floor -) 100% completed,13 -30% completed
- Wall chasing work -BF1- -9th floor – 100% completed.
- Door Frame Fixing -BF1-90% Completed,GF-4 th floor -100% completed,5-9 th floor (13% completed)
- Internal wall plastering work -BF1 (70% completed); GF, 1st-6 th floor (100% completed),7th floor -50% completed.
- Dadoing of toilets :GF -15% Completed,First floor -25% completed, dadaoing of kitchen walls:1 st floor -25% completed
- Wire pulling : 1st-floor -10% completed
- Water Proofing work – BF1-30% Completed,GF – 100% completed; 1st-3rd floor – 100% completed,4-5th floor -50% completed
- Putty work (2coat) – BF1-70% Completed,GF- 4 th floor -100% completed
- Plumbing work -(GF-2nd floor) -100% completed,3rd floor -50% completed,4 th floor -20% completed.
- Balcony Handrail work -1 st floor -65% completed,2-9 th floor -50% completed.
- MLCP Pile cap work completed.
- Foundation work -60% completed
- mock up flat -ceiling plastering ,block and brick masonry ,door frame fixing ,electrical chasing ,plumbing work ,wall chasing ,wall plastering ,dadoing of toilets ,kitchen walls ,application of putty on wall sand ceiling ,water proofing ,flooring and skirting ,aluminium doors and window fixing ,door shutter fixing ,grills and handrails fixing (100% completed),wire pulling (25% completed)
Tower 2
- Column work – BF1 – 100% completed
- Column rising work – 1st floor – 100% completed
- Column rising work – 2nd floor -100% completed
- Column rising work – 3rd floor -100% completed
- Column rising work – 4th floor -75% completed
- RCC for slab – BF2 roof slab – 100% completed
- RCC for slab – BF1 roof slab – 100% completed
- RCC for slab – First floor roof slab – 100% completed
- RCC for slab -Second floor roof slab -100% completed
- RCC for slab -Third floor roof slab -100% completed
- RCC for slab -fourth roof slab -40% completed
As per the current work status from our site we are targeted to complete the following works by end of April 2019
Tower 1
- Column work – 16th floor – 100% to be completed
- RCC for slab – 17th floor – 100% to be completed
- Block work – 11th floor – 100% to be completed,12 th floor -50% to be completed
- Ceiling Plastering work – 13th floor – 100% to be completed
- Wall chasing work – 10th floor – 100% completed
- Internal wall plastering work – 8 th floor 100 %to be completed
- Plumbing Sleeve Fixing -8 th floor -100% to be completed
- Balcony Handrail work -up to -10th floor -100% to be completed
Tower 2
- Column rising work – 4th floor -100% completed
- RCC for slab -fourth roof slab -100% completed
Work status as on 05.04.2019, we have completed the following
Tower 1
- Column work – 16 floor – 75% completed
- RCC for slab -17 th floor -45%completed
- Block work – 11 th floor -70% completed
- Ceiling Plastering work – 12th floor – 100% completed,13 -30% completed
- Wall chasing work – 8th floor – 100% completed,9 th floor completed
- Internal wall plastering work -BF1 (70% completed); GF, 1st-6 th floor (100% completed),7th floor -80% to becompleted.
- Water Proofing work – GF – 100% completed; 1st 6 th floor – 100% completed.
- Putty work (2coat) – GF- 4 th floor -100% completed
- Plumbing Sleeve Fixing -6 th floor -100% completed
- Balcony Handrail work -up to -8 th floor -100% completed
- MLCP Pile cap work completed.
- Foundation work -60% completed
Tower 2
- Column work – BF1 – 100% completed
- Column rising work – 1st floor – 100% completed
- Column rising work – 2nd floor -100% completed
- Column rising work – 3rd floor -100% completed
- Column rising work – 4th floor -75% completed
- RCC for slab – BF2 roof slab – 100% completed
- RCC for slab – BF1 roof slab – 100% completed
- RCC for slab – First floor roof slab – 100% completed
- RCC for slab -Second floor roof slab -100% completed
- RCC for slab -Third floor roof slab -100% completed
- RCC for slab -fourth roof slab -10% completed
As per the current work status from our site we are targeted to complete the following works by end of March 2019
Tower 1
- Column work – 16th floor – 100% to be completed
- RCC for slab – 17th floor – 50% to be completed
- Block work – 11th floor – 100% to be completed,12 th floor -50% to be completed
- Ceiling Plastering work – 13th floor – 100% to be completed
- Wall chasing work – 10th floor – 100% completed
- Internal wall plastering work – 6 th floor 100 %to be completed
- Water Proofing work -6 th floor (100% to be completed)
- Putty work (2coat) – 6th floor – 100% to be completed
Tower 2
- Column rising work – 4th floor -100%to be completed
- RCC for slab -Third floor roof slab -100% tobe completed
Work status as on 06-03-2019, we have completed the following
Tower 1
- Column work – 15th floor – 100% completed
- RCC for slab -16 th floor -50%completed
- Block work – 11 th floor -70% completed
- Ceiling Plastering work – 12th floor – 100% completed,13 -10% completed
- Wall chasing work – 8th floor – 100% completed,10 on progress
- Internal wall plastering work -BF1 (70% completed); GF, 1st,2nd floor (100% completed);3rd floor -(100%completed ),4 th floor -100%completed,5 th floor -100 %completed,6 th floor -25%completed.
- Water Proofing work – GF – 100% completed; 1st floor – 100% completed.2,3,4,5(100% to be completed)
- Putty work (2coat) – GF, 1st floor (100% completed),2nd floor -100% completed,3 rd floor -100% completed
- MLCP Pile cap work completed.
Tower 2
- Column work – BF1 – 100% completed
- Column rising work – 1st floor – 100% completed
- Column rising work – 2nd floor -100% completed
- Column rising work – 3rd floor -100% completed
- RCC for slab – BF2 roof slab – 100% completed
- RCC for slab – BF1 roof slab – 100% completed
- RCC for slab – First floor roof slab – 100% completed
- RCC for slab -Second floor roof slab -100% completed
- RCC for slab -Third floor roof slab -Shuttering on progress
As per the current work status from our site we are targeted to complete the following works by end of February 2019
Tower 1
- Column work – 15th floor – 100% to be completed
- RCC for slab – 16th floor – 80% to be completed
- Block work – 11th floor – 100% to be completed,12 th floor -50% to be completed
- Ceiling Plastering work – 13th floor – 100% to be completed
- Wall chasing work – 10th floor – 100% completed
- Internal wall plastering work – 6 th floor 100 %to be completed
- Water Proofing work -2-3rd floor (100% to be completed)
- Putty work (2coat) – 3rd floor – 100% to be completed
- MLCP Pile cap work 85% to be completed
Tower 2
- Column rising work – 3rdfloor -100% to be completed
- RCC for slab -third floor roof slab – 50% to be completed
Work status as on 05-02-2019, we have completed the following
Tower 1
- Column work – 14th floor – 100% completed,15 th floor -30%completed
- RCC for slab -15 th floor -50%completed
- Block work – 11 th floor -70% completed
- Ceiling Plastering work – 12th floor – 100% completed,13 -10% completed
- Wall chasing work – 9th floor – 100% completed,10 on progress
- Internal wall plastering work -BF1 (70% completed); GF, 1st,2nd floor (100% completed);3rd floor -(100%completed ),4 th floor -100%completed,5 th floor -100 %completed,6 th floor -25%completed.
- Water Proofing work – GF – 100% completed; 1st floor – 100% completed.2-3rd floor (50% to be completed)
- Putty work (2coat) – GF, 1st floor (100% completed),2nd floor -100% completed
- MLCP Pile cap work 70%completed, rising work on progress
Tower 2
- Column work – BF1 – 100% completed
- Column rising work – 1st floor – 100% completed
- Column rising work – 2nd floor -100% completed
- Column rising work – 3rdfloor -50% to be completed
- RCC for slab – BF2 roof slab – 100% completed
- RCC for slab – BF1 roof slab – 100% completed
- RCC for slab – First floor roof slab – 100% completed
- RCC for slab – second floor roof slab – 100%completed
As per the current work status from our site we are targeted to complete the following works by end of January 2019
Tower 1
- Column work – 15th floor – 100% to be completed
- RCC for slab – 15th floor – 100% to be completed
- Block work – 11th floor – 100% to be completed
- Ceiling Plastering work – 13th floor – 100% to be completed
- Wall chasing work – 10th floor – 100% completed
- Internal wall plastering work – 5 th floor.6 th floor 100 %to be completed
- Putty work (2coat) – 3rd floor – 100% to be completed
Tower 2
- Column rising work – 3rdfloor – 50% to be completed
- RCC for slab – second floor roof slab – 100%to be completed
Work status as on 08-01-2019, we have completed the following
Tower 1
- Column work – 13th floor – 100% completed,14 th floor -90%completed
- RCC for slab – 14 th floor -100% completed,15 th floor -50%completed
- Block work – 10th floor – 100% completed,11 th floor -40% completed
- Ceiling Plastering work – 12th floor – 100% completed,13 on progress
- Wall chasing work – 9th floor – 100% completed,10 on progress
- Internal wall plastering work -BF1 (70% completed); GF, 1st,2nd floor (100% completed);3rd floor -(100%completed ),4 th floor -100%completed,5 th floor -25 %completed.
- Water Proofing work – GF – 100% completed; 1st floor – 100% completed;
- Putty work (2coat) – GF, 1st floor (100% completed),2nd floor -100% completed
- MLCP Pile cap work 60%completed, rising work on progress
Tower 2
- Column work – BF1 – 100% completed
- Column rising work – 1st floor – 100% completed
- Column rising work – 2nd floor -100% completed
- RCC for slab – BF2 roof slab – 100% completed
- RCC for slab – BF1 roof slab – 100% completed
- RCC for slab – First floor roof slab – 100% completed
As per the current work status from our site we are targeted to complete the following works by end of Decemeber 2019
Tower 1
- Column work – 14th floor – 100% to be completed
- RCC for slab – 14th floor – 100% to be completed
- Block work – 11th floor – 100% to be completed
- Ceiling Plastering work – 13th floor – 100% to be completed
- Wall chasing work – 10th floor – 100% completed
- Internal wall plastering work – 3rd floor – 100% to be completed
- Putty work (2coat) – 2nd floor – 100% to be completed
- Pile cap work 50% to be completed
Tower 2
- RCC for slab – secon floor roof roof slab – 100% to becompleted
- Column rising work – 2nd floor – 100% to be completed
Work status as on 06-12-2018, we have completed the following
Tower 1
- Column work – 13th floor – 100% completed,14 th floor on progress
- RCC for slab – 13th floor – 100% completed,14 th floor -50% completed
- Block work – 10th floor – 100% completed,11 th floor -20% completed
- Ceiling Plastering work – 12th floor – 100% completed,13 on progress
- Wall chasing work – 9th floor – 100% completed,10 on progress
- Internal wall plastering work -BF1 (70% completed); GF, 1st,2nd floor (100% completed);3rd floor -(20%completed )
- Water Proofing work – GF – 100% completed; 1st floor – 100% completed;
- Putty work (2coat) – GF, 1st floor (100% completed),2nd floor on progress
- MLCP Pile rising work on progress
Tower 2
- Column work – BF1 – 100% completed
- RCC for slab – BF3 roof slab – 100% completed
- RCC for slab – BF2 roof slab – 100% completed
- RCC for slab – BF1 roof slab – 100% completed
- RCC for slab – First floor roof slab – 100% completed
- Column rising work – 1st floor – 100% completed
- Column rising work – 2nd floor -40% completed
As per the current work status from our site we are targeted to complete the following works by end of November 2018
Tower 1
- Column work – 13th floor – 100% to be completed
- RCC for slab – 14th floor – 100% to be completed
- Block work – 12th floor – 100% to be completed
- Ceiling Plastering work – 13th floor – 100% to be completed
- Internal wall plastering work – 2nd floor – 100% to be completed
- Putty work (2coat) – GF – 100% to be completed
Tower 2
- Column rising work – 2nd floor – 100% to be completed
- Slab Rcc work – 2nd floor – 100% to be completed
Work status as on 16-11-2018, we have completed the following
Tower 1
- Column work – 13th floor – 50% completed
- RCC for slab – 13th floor – 100% completed
- Block work – 12th floor – 50% completed
- Ceiling Plastering work – 12th floor – 100% completed
- Wall chasing work – 9th floor – 100% completed
- Internal wall plastering work -BF1 (70% completed); GF (100% completed); 1st floor (100% completed)
- Water Proofing work – GF – 100% completed; 1st floor – 100% completed;
- Putty work (2coat) – GF (80% completed); 1st floor (100% completed)
Tower 2
- Column work – BF1 – 100% completed
- RCC for slab – BF3 roof slab – 100% completed
- RCC for slab – BF2 roof slab – 100% completed
- RCC for slab – BF1 roof slab – 100% completed
- Column rising work – 1st floor – 100% completed
- Slab Rcc work – 2nd floor – 50% completed
Work Schedule for the Month of July 2018
Tower 1
- Column work – 12th floor – 100% to be completed.
- RCC for slab – 12th & 13th floor – 100% to be completed.
- Block work – 10th floor – 100% to be completed.
- Ceiling Plastering work – 11th floor – 100% to be completed.
- Wall chasing work – 8th floor – 100% to be completed.
Tower 2
- GF column work – 100% to be completed.
- GF roof rcc work – 60% to be completed.
Work status as on 05-06-2018, we have completed the following
Tower 1
- Column work – 12th floor – 50% completed.
- RCC for slab – 12th floor half portion – 50% completed.
- Block work – 10th floor – 25% completed.
- Ceiling Plastering work – 10th floor – 100% completed.
- Wall chasing work – 8th floor – started.
- Internal wall plastering work – GF (100% completed); 1st floor (100% completed).
- Water Proofing work – GF – 50% completed; 1st floor – 100% completed.
Tower 2
- Column work – 12th floor – 100% to be completed.
- RCC for slab – 12th & 13th floor – 100% to be completed.
- Block work – 10th floor – 100% to be completed.
- Ceiling Plastering work – 11th floor – 100% to be completed.
- Wall chasing work – 8th floor – 100% to be completed.
- Water Proofing work – GF – 100% to be completed.
As per the current work status from our site we are targeted to complete the following works by end of May 2018
Tower 1
- Column work – 11th floor – 50% to be completed
- RCC for slab – 11th floor – 100% to be completed
- Block work – 9th floor – 100% to be completed
- Wall chasing work -6th floor – 100% to be completed
- Internal wall plastering work – 1st floor -100% to be completed
Tower 2
- Column work – BF1 – 100% to be completed
- RCC for slab – GF roof slab -100% to be completed
Work status as on 05-05-2018, we have completed the following.
Tower 1
- Column work – 10th floor – 100% completed
- RCC for slab – 1st to 9th floor (100% completed);10th floor (100% completed)
- Block work – 8th floor (100% completed); 9th floor (50% completed)
- Ceiling Plastering work – BF2, BF1 & GF to 9th floor (100% completed)
- Wall chasing work – GF ,1st,2nd,3rd, 4th & 5th floor (100% completed)
- Internal wall plastering work – GF (50% completed); 1st floor (90% completed)
Tower 2
- Column work – BF1 – 90% completed
- RCC for slab – BF3 roof slab – 100% completed
- RCC for slab – BF2 roof slab – 100% completed
- RCC for slab – GF roof slab – 70% completed
- RCC for slab – BF1 roof slab – 100% completed
Work status as on 9-5-2017, we have completed the following.
Tower 1
- Pile cap – completed
- Plinth beam – progressing
- Column work – 100% completed
- Column work – 100% completed
- RCC for slab – 100% completed
Tower 2
-
- Plinth beam – completed
- RCC for slab – completed
As per the current work status from our site we are targeted to complete the following works by end of April 2018
Tower 1
-
-
- Column work – 100% to be completed
- RCC for slab – 10th floor – 100% to be completed
- Block work -8th floor – 100% to be completed
- Ceiling Plastering work – 100% to be completed
- Wall chasing work -100% to be completed
- Internal wall plastering work – 1st floor-100% to be completed
-
Work status as on 14-04-2018, we have completed the following.
Tower 1
-
-
- RCC for slab – 1st to 9th floor (100% completed);10th floor(50% completed)
- Block work – BF2, BF1,GF & 1st to 7th floor(100% completed);8th floor (50% completed)
- Ceiling Plastering work – BF2, BF1 & GF to 8th floor (100% completed)
- Wall chasing work – GF ,1st,2nd,3rd & 4th floor (100% completed)
- Internal wall plastering work – 1st floor (75% completed)
-
Tower 2
-
-
- Plinth beam – 100% completed
- Column work – BF3 – 100% completed
- Column work – BF2 – 100% completed
- Column work – BF1 – 90% completed
- RCC for slab – BF3 roof slab – 100% completed
- RCC for slab – BF2 roof slab – 100% completed
- RCC for slab -GF roof slab – 40% completed
- RCC for slab – BF1 roof slab – 100% completed
-
-
As per the current work status from our site we are targeted to complete the following works by end of March 2018
Tower 1
-
-
- Column work – 9th floor – 100% to be completed
- RCC for slab – 10th floor – 100% to be completed
- Block work -7th floor – 100% to be completed
- Ceiling Plastering work – 100% to be completed
- Internal wall plastering work – 1st floor-100% to be completed
- Wall chasing work -3rd floor-100% to be completed
-
Work status as on 10-03-2018, we have completed the following.
Tower 1
-
-
- Pile cap – 100% completed
- Plinth beam – 100% completed
- Column work – 2nd, 3rd,4th, 5th, 6th& 7th floor- 100% completed; 8th floor(100% completed);9th floor(60% completed)
- RCC for slab – 1st,2nd,3rd, 4th ,5th,6th,7th & 8th floor roof(100% completed);9th floor (100% completed);10th floor(progressing)
- Block work – BF2, BF1,GF -100% completed; 1st , 2nd, 3rd, 4th& 5th floor(100% completed);6th floor(100% completed);7th floor(50% completed)
- Ceiling Plastering work – BF2, BF1,& GF to 5th floor (100% completed);6th,7th floor (100% completed)
- Internal wall plastering work – 1st floor (25% completed)
- Wall chasing work – GF & 1st floor (100% completed);2nd floor(100% completed);3rd floor(60% completed)
-
Work status as on 09 -02-2018, we have completed the following.
Tower 1
-
-
- Column work – 2nd, 3rd,4th, 5th, 6th& 7th floor- 100% completed; 8th floor-60% completed
- RCC for slab – 1st,2nd,3rd, 4th ,5th,6th,7th & 8th floor roof(100% completed);9th floor (50% completed)
- Block work – BF2, BF1,GF -100% completed; 1st , 2nd, 3rd, 4th& 5th floor(100% completed);6th floor(25% completed)
- Ceiling Plastering work – BF2, BF1,& GF to5th floor – (100% completed);6th floor (90% completed)
- Wall chasing work – GF & 1st floor (100% completed);2nd floor(75% completed)
-
As per the current work status from our site we are targeted to complete the following works by end of February 2018
Tower 1
-
-
- Column work – 8th floor – 100% to be completed
- RCC for slab – 9th floor – 100% to be completed
- Block work -6th floor – 100% to be completed
- Ceiling Plastering work – 6th floor – 100% to be completed
- Wall chasing work -100% to be completed
- Internal wall plastering work – 100% to be completed
-
Work status as on 5-7-2017, we have completed the following.
Tower 1
-
-
- Pile cap – completed
- Plinth beam – progressing
- Column work -progressing
-
Work status as on 9-6-2017, we have completed the following.
Tower 1
-
- Pile cap – completed
- Plinth beam – completed
- Column work – BF3 – completed
- Column work – BF2 – completed
- Column work – BF1 – completed
- RCC for slab – BF3 roof slab – completed
- RCC for slab – BF2 roof slab – progressing
- RCC for slab – BF1 roof slab – progressing
Work status as on 8-2-2017, we have completed the following.
Tower 1
- Pile cap – progressing
- Column work – progressing
- RCC for slab – progressing
Tower 2
- Plinth beam – completed
- Column work -preogressing
- RCC for slab – progressing
