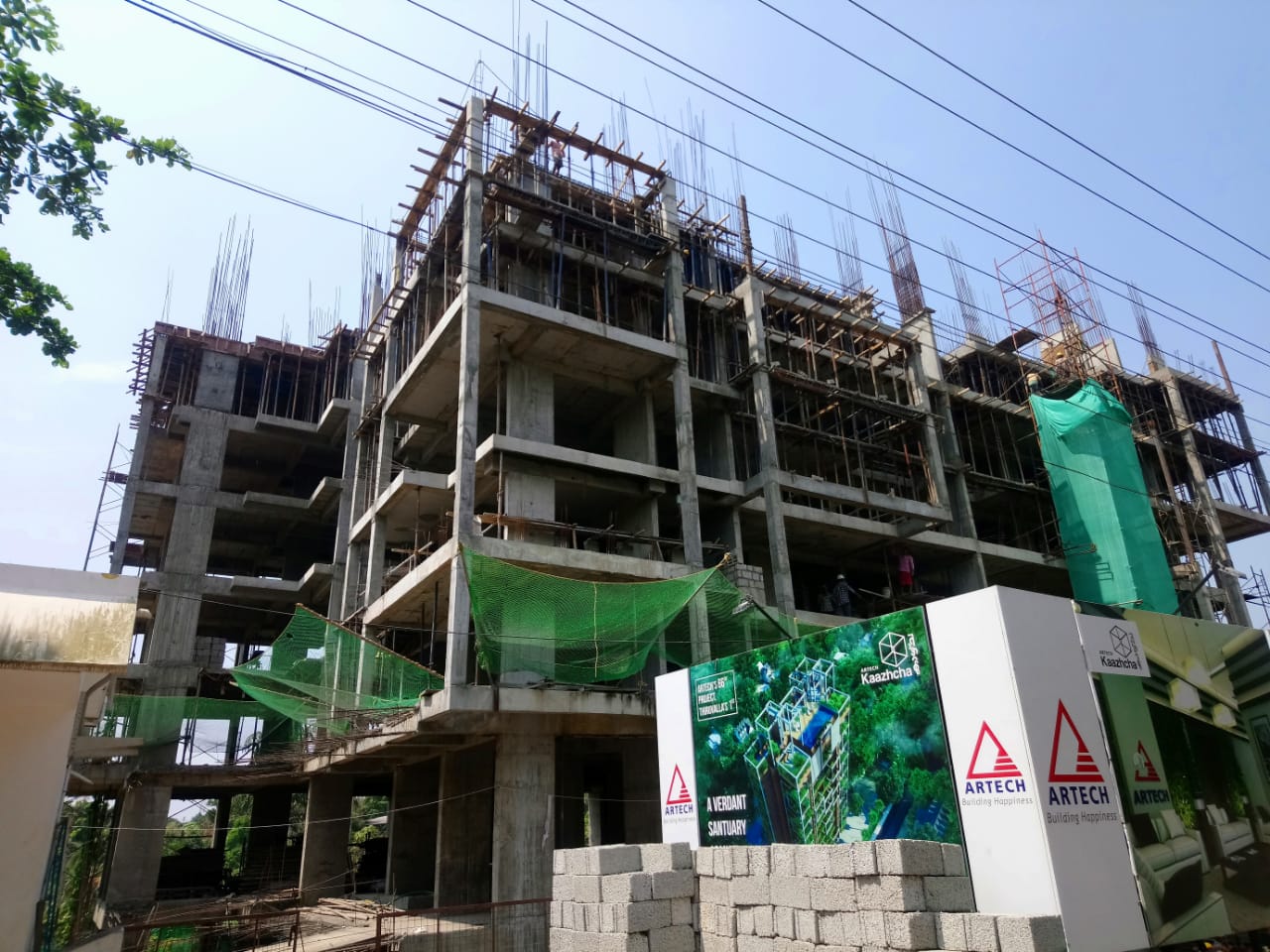

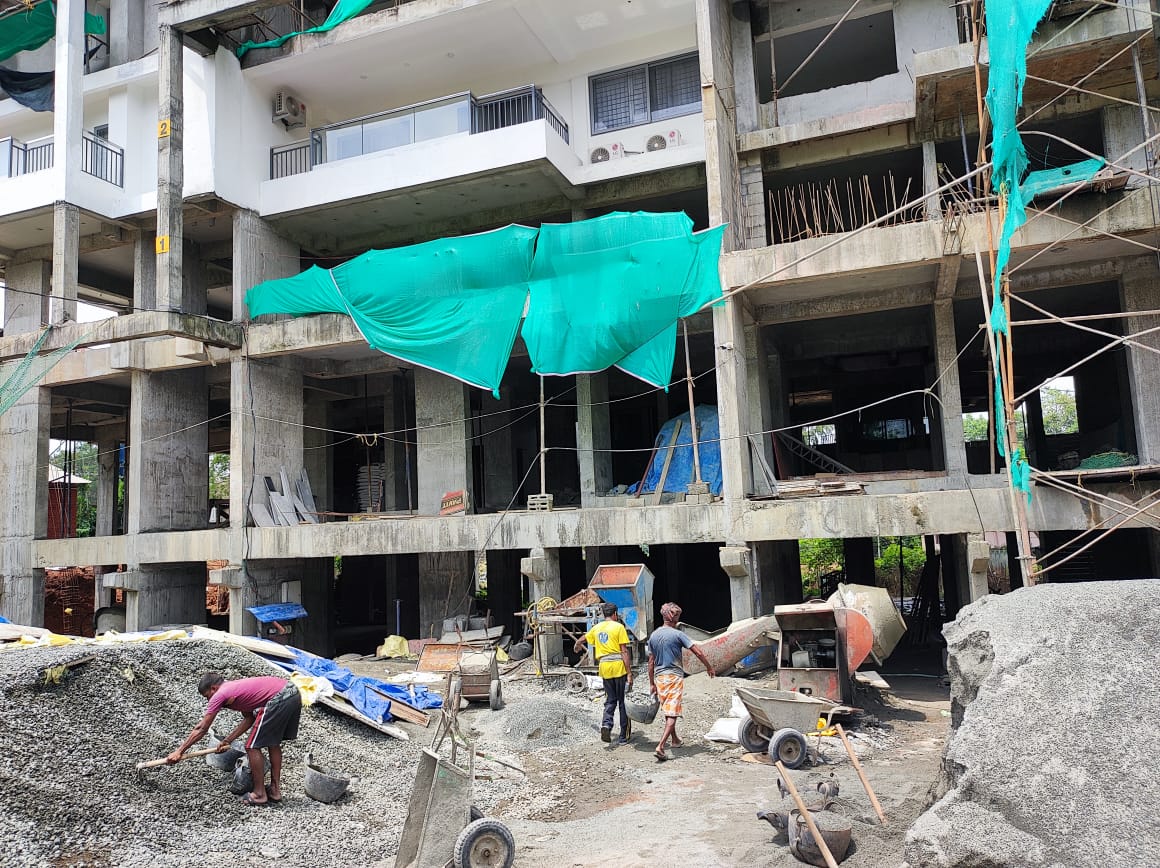

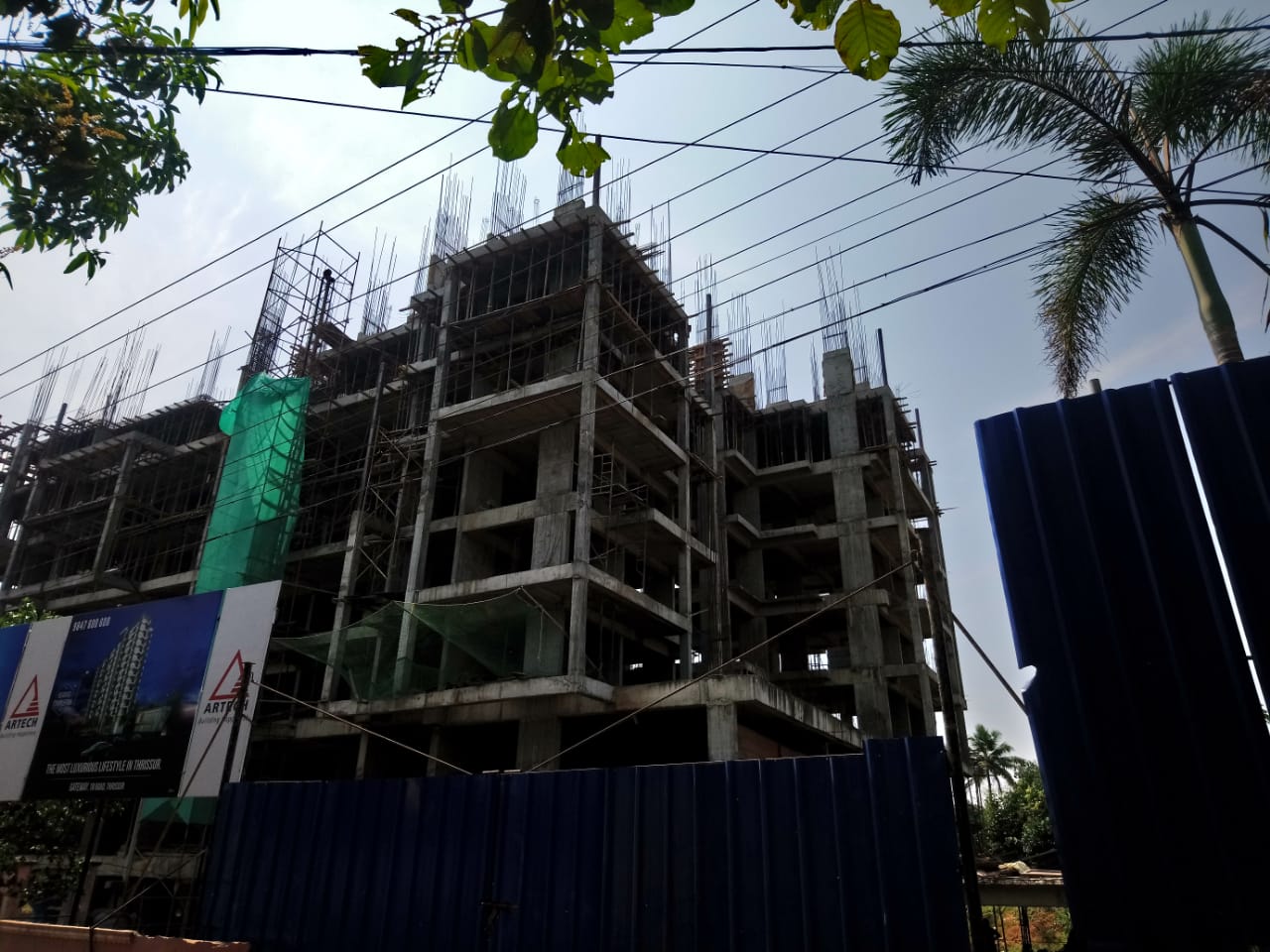

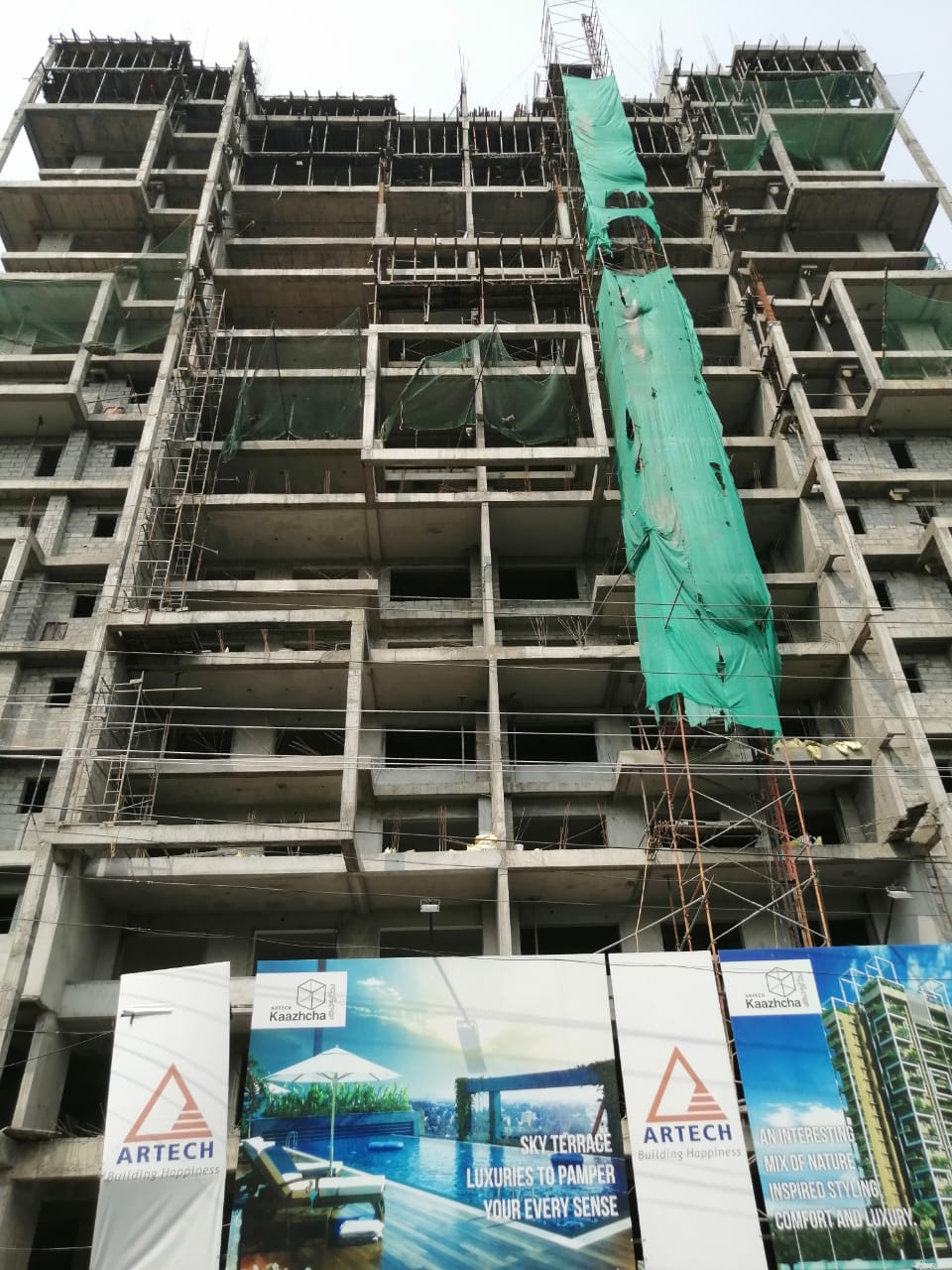

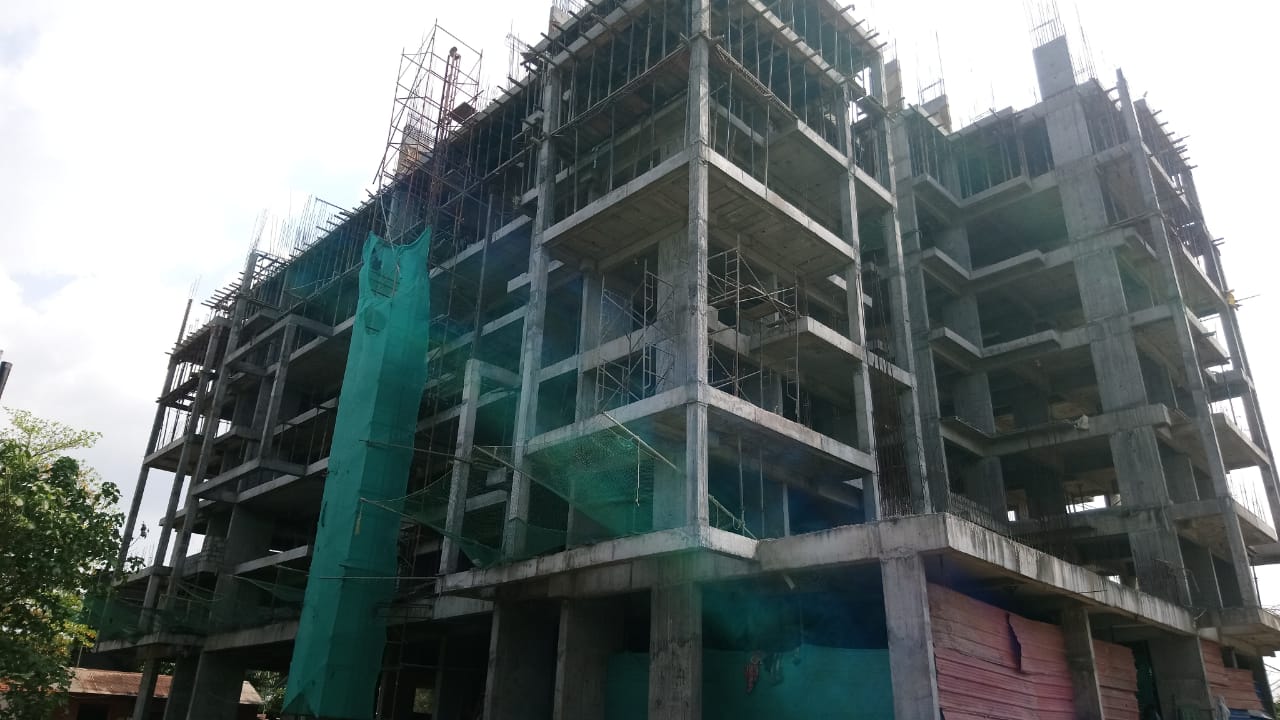

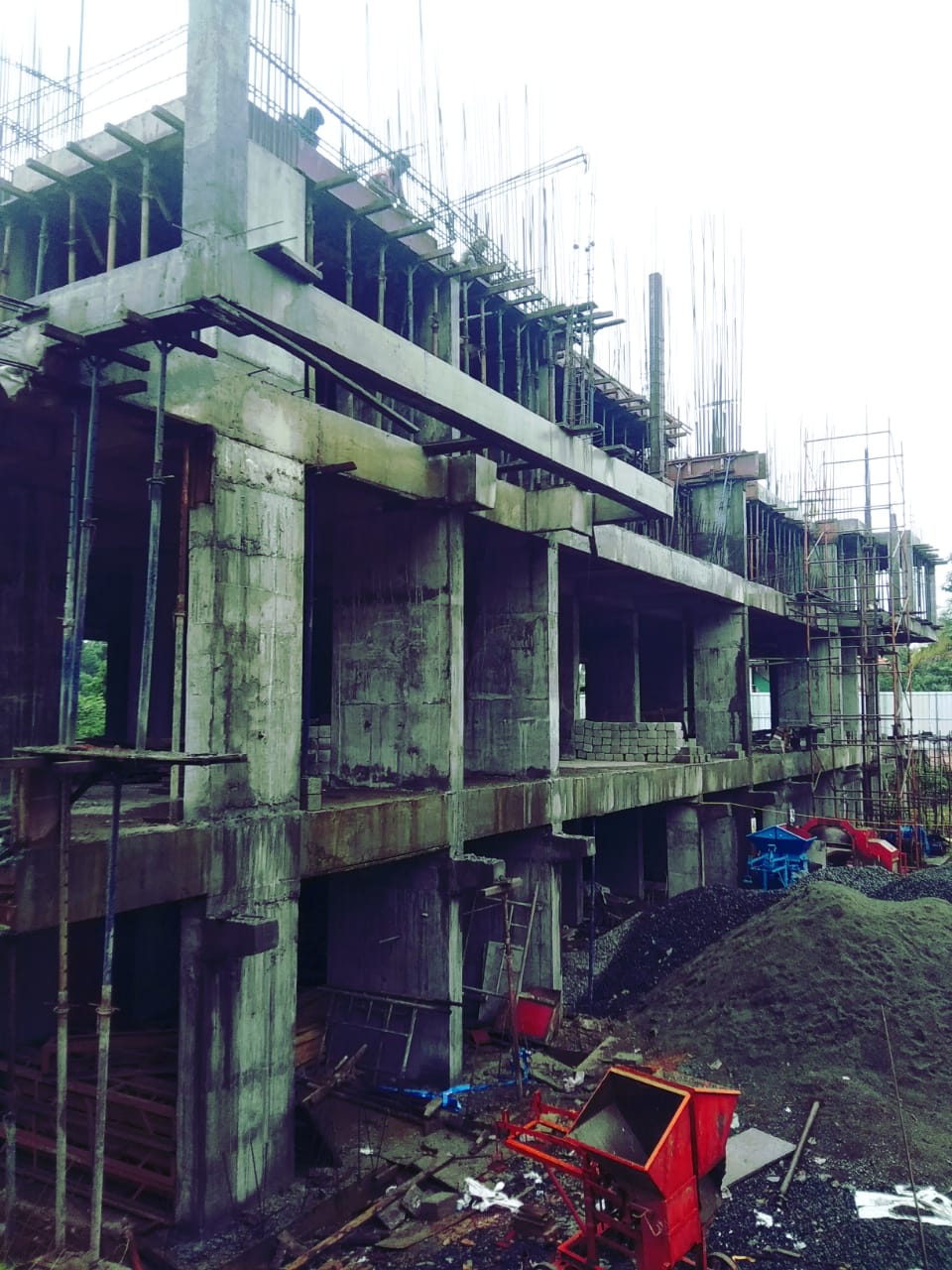

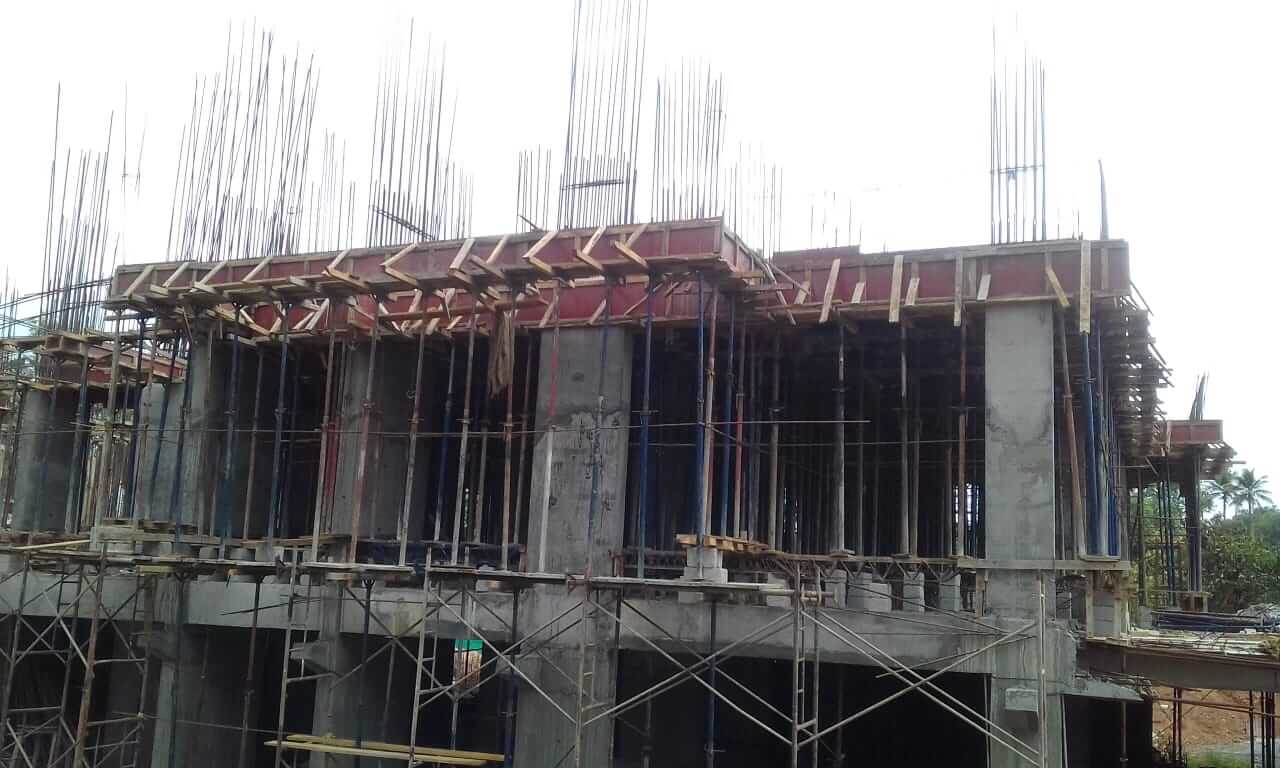

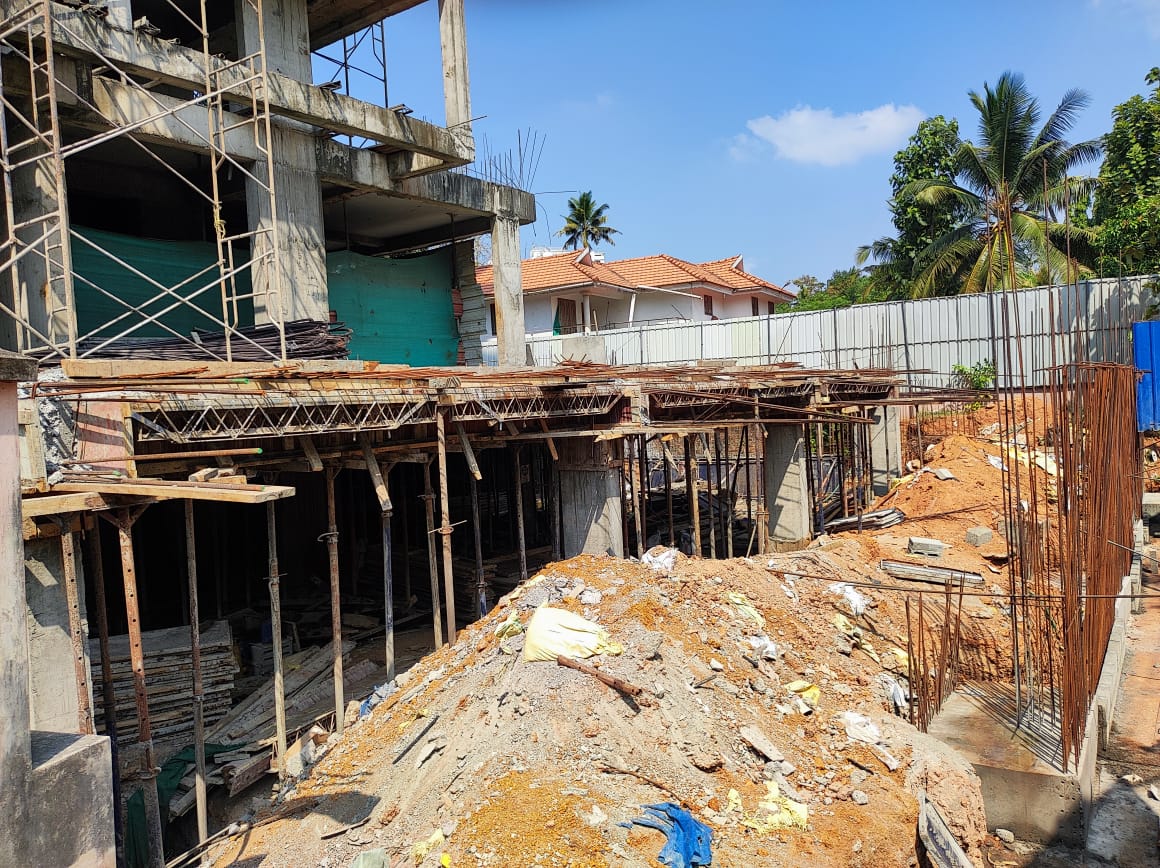

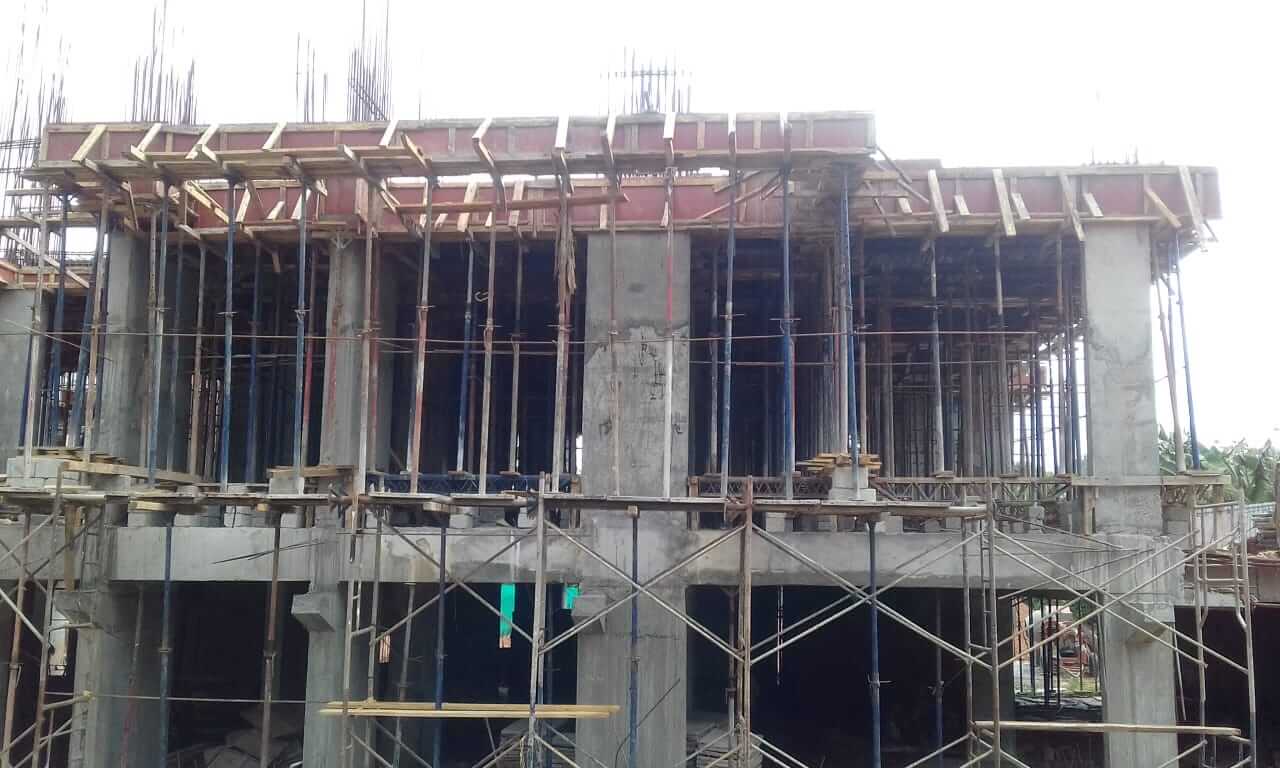

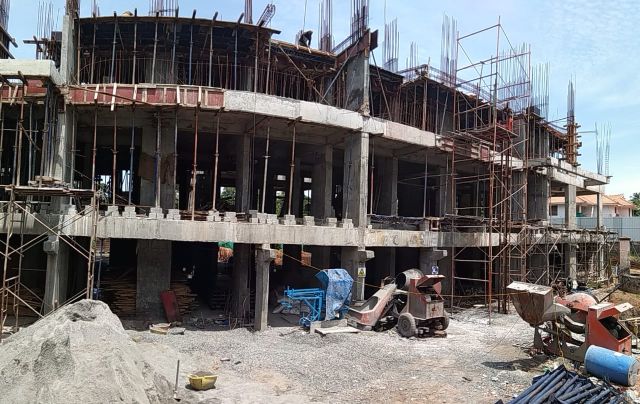

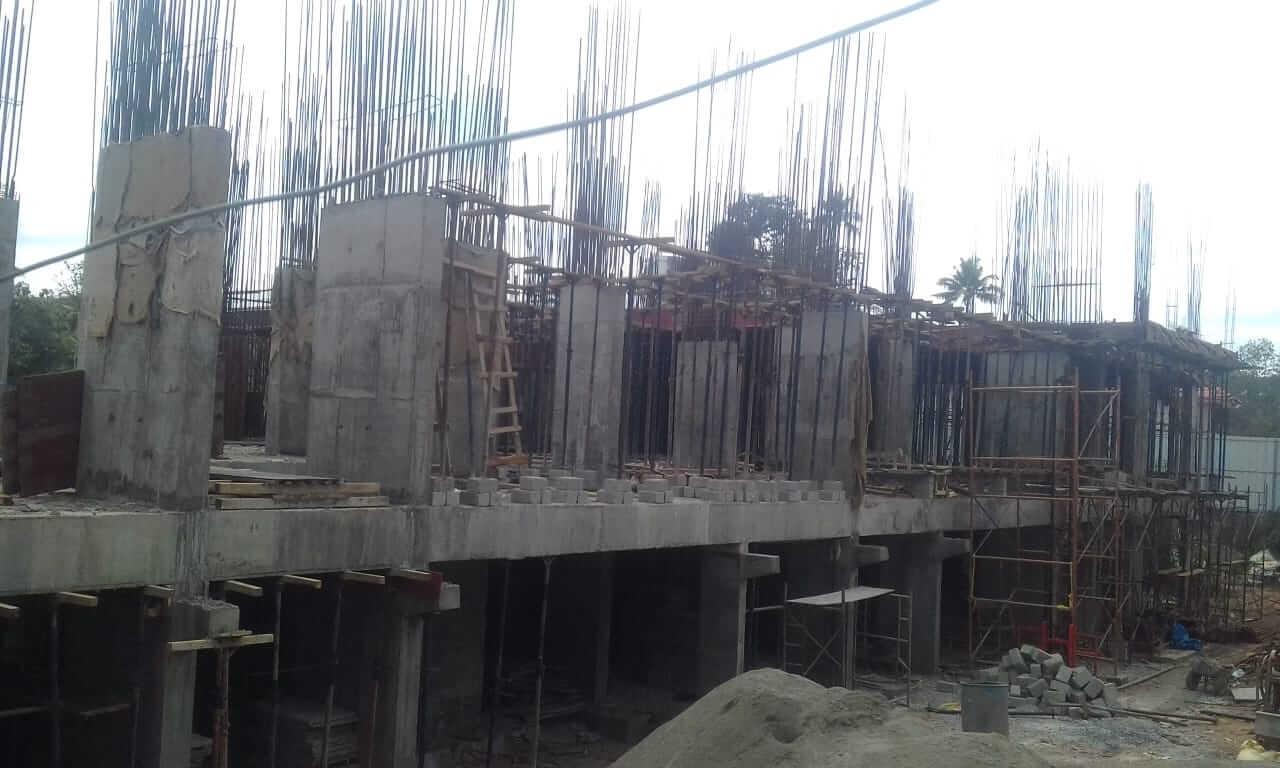

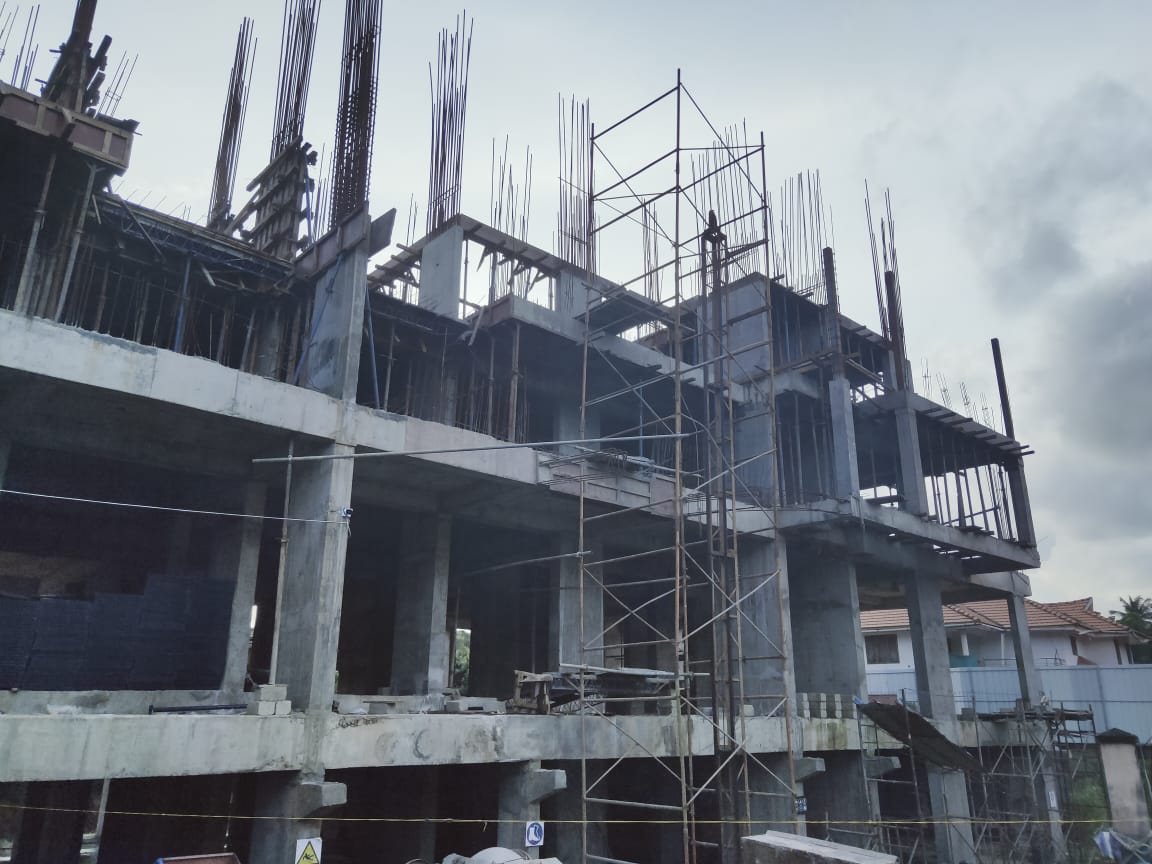

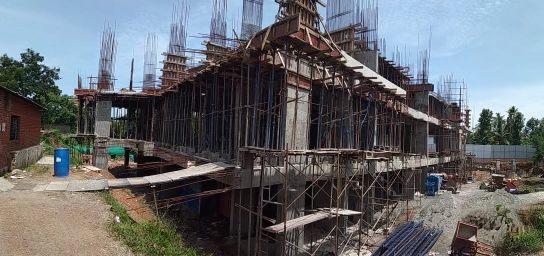

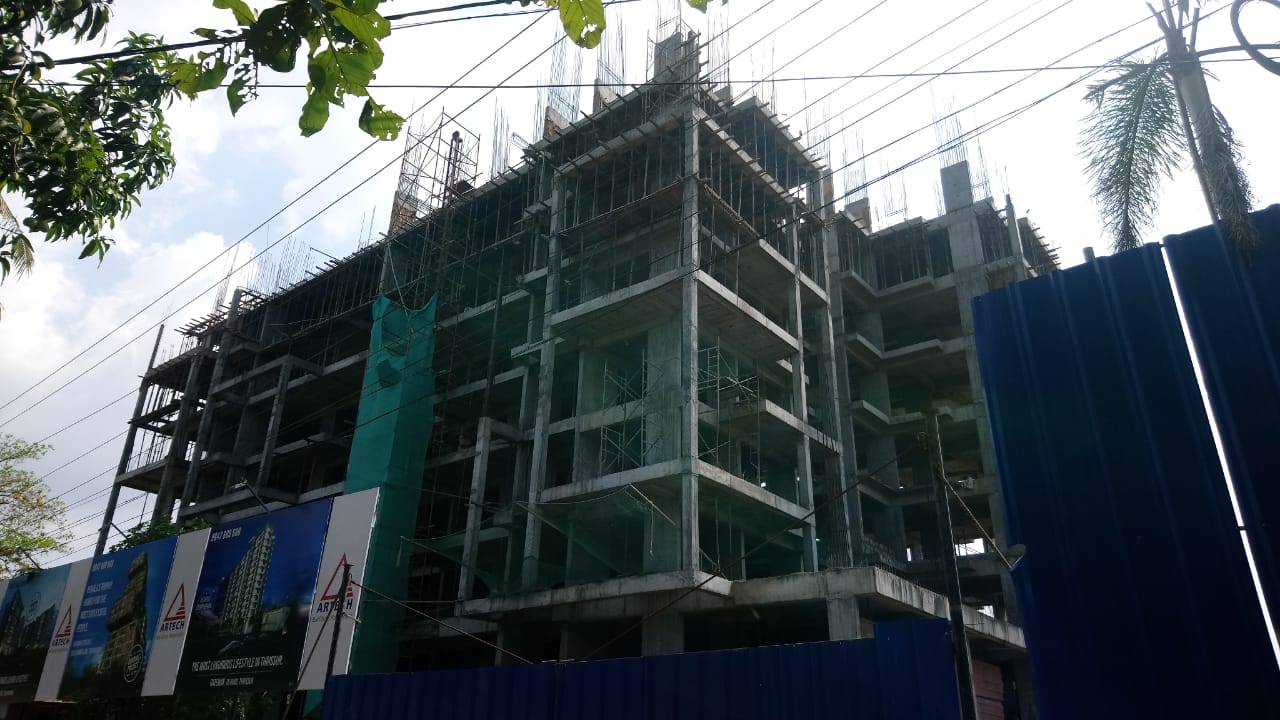

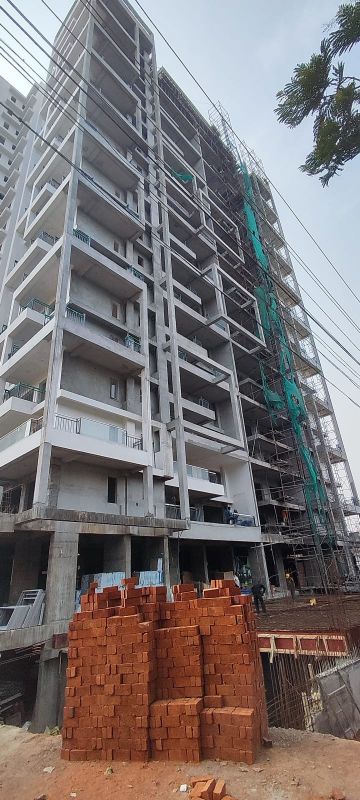

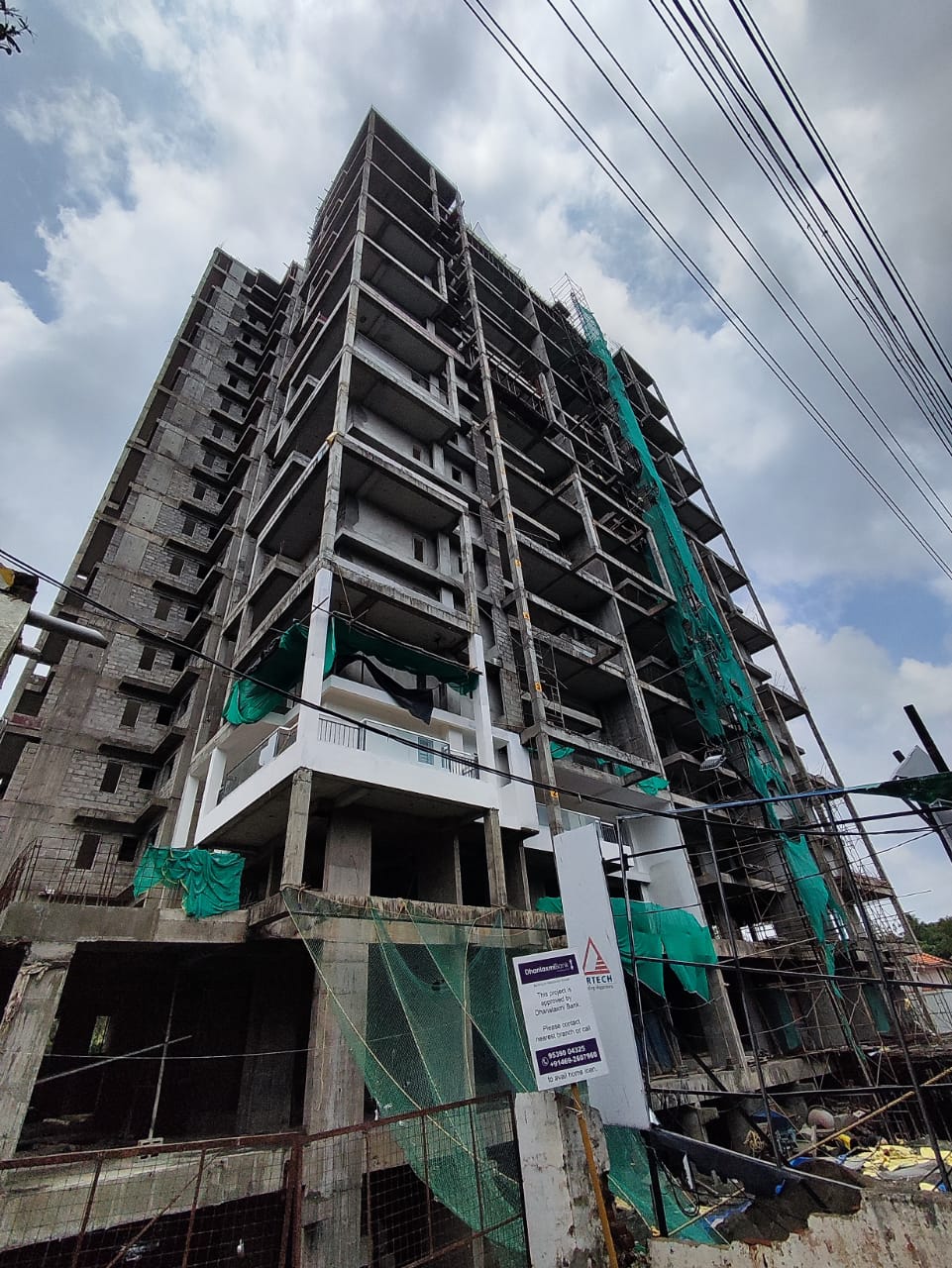

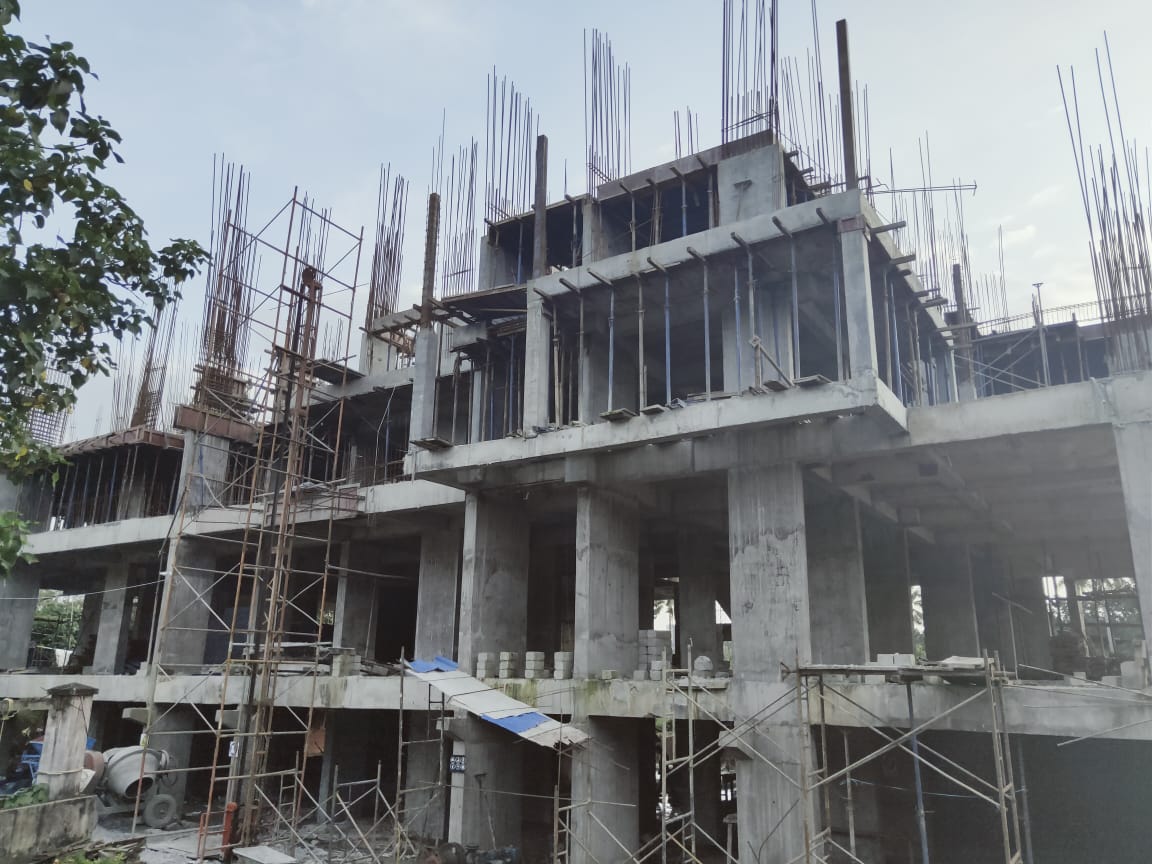

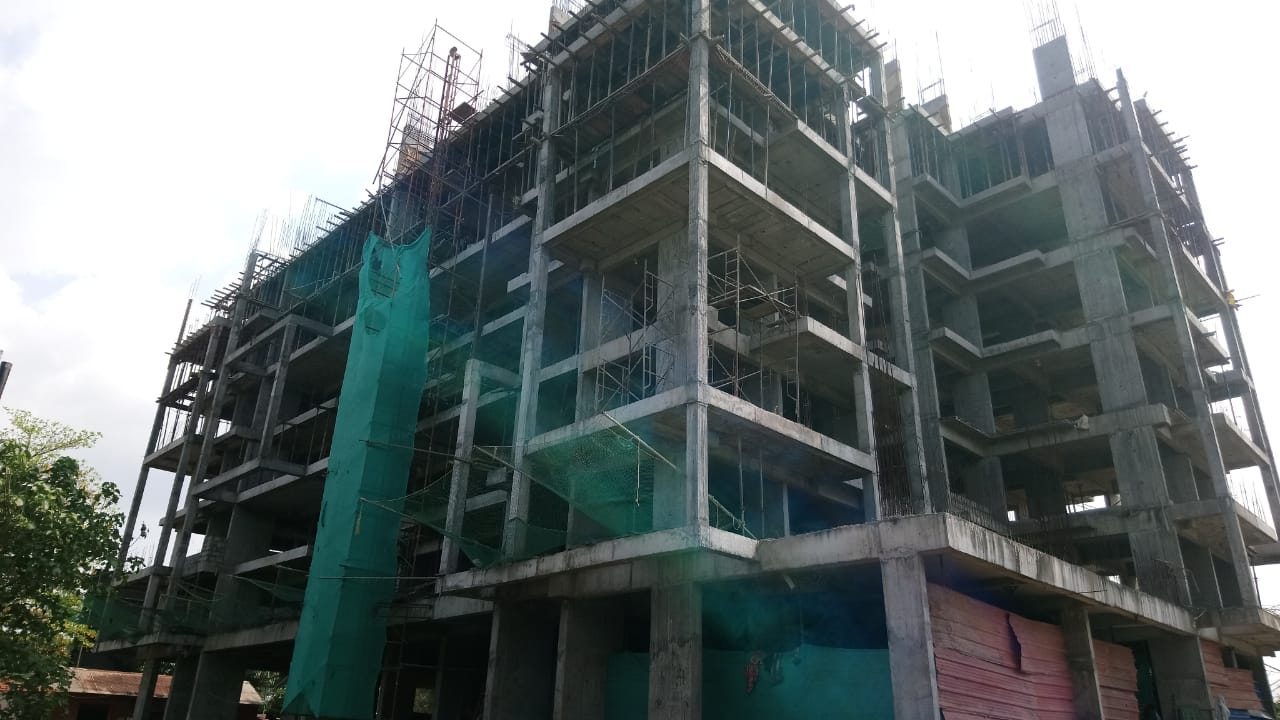

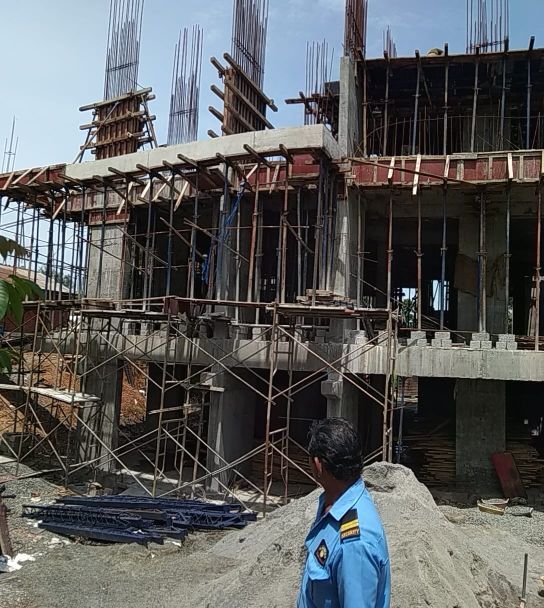

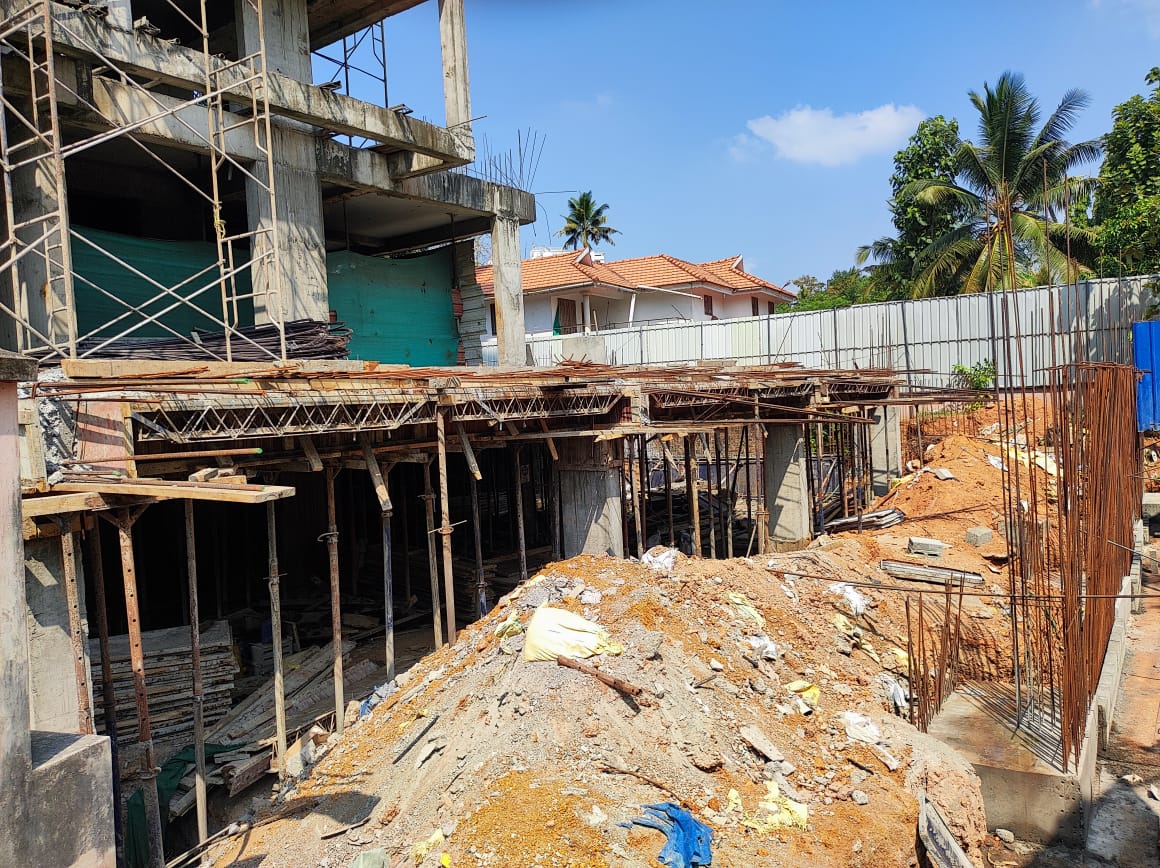

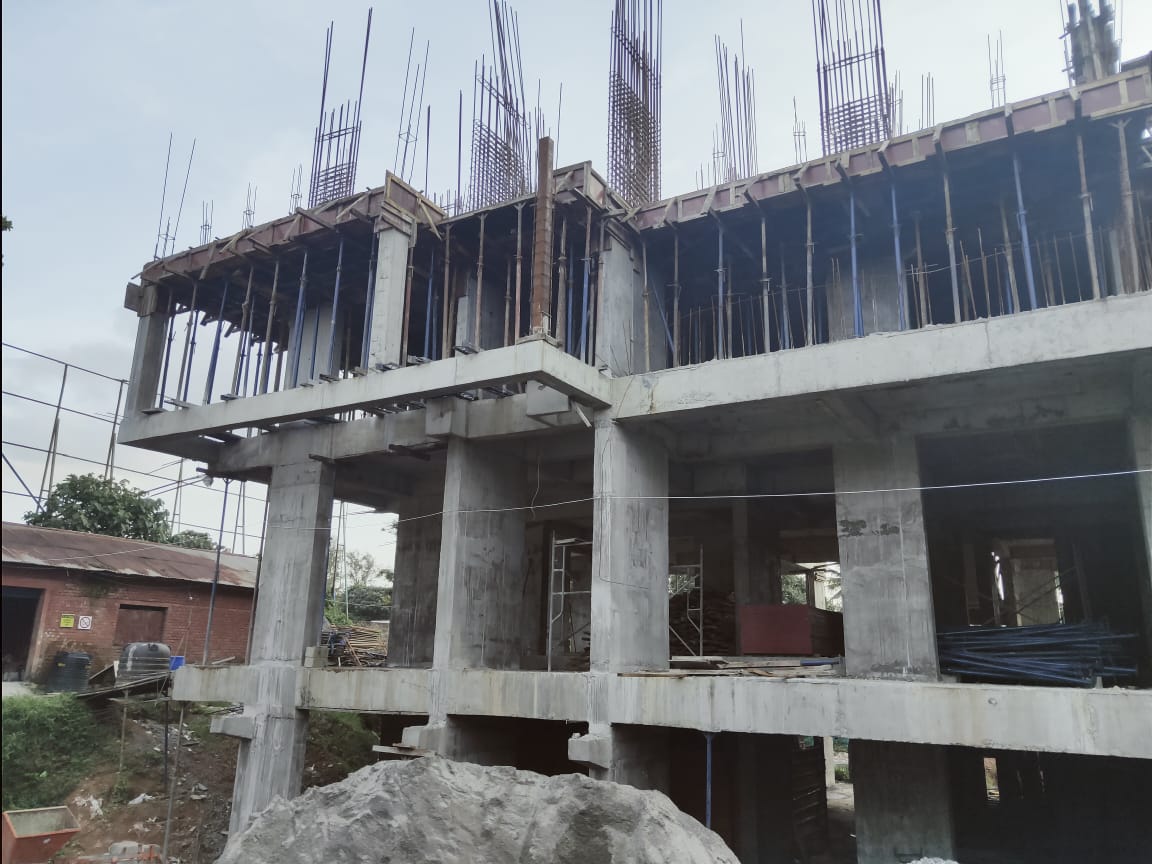

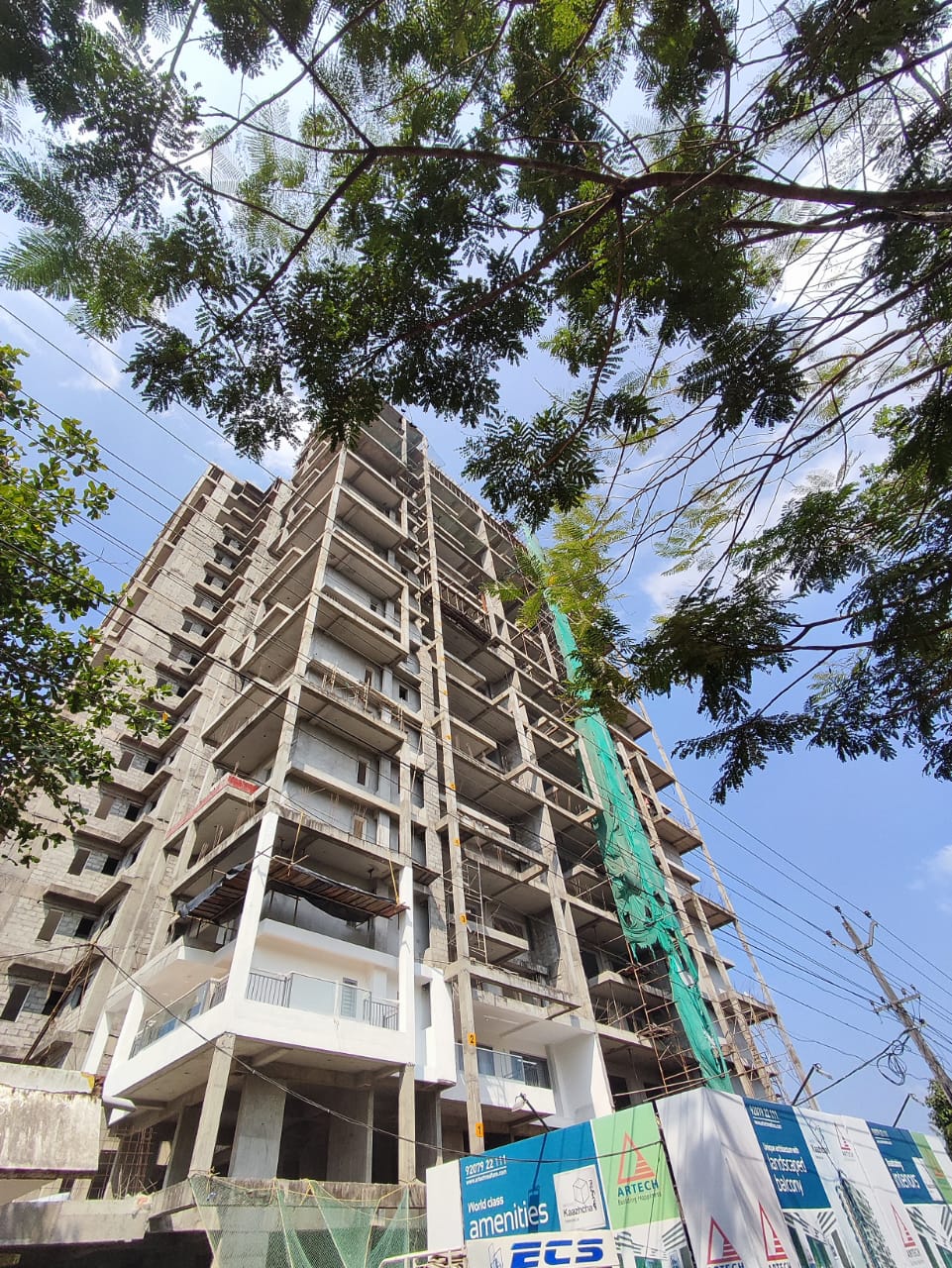

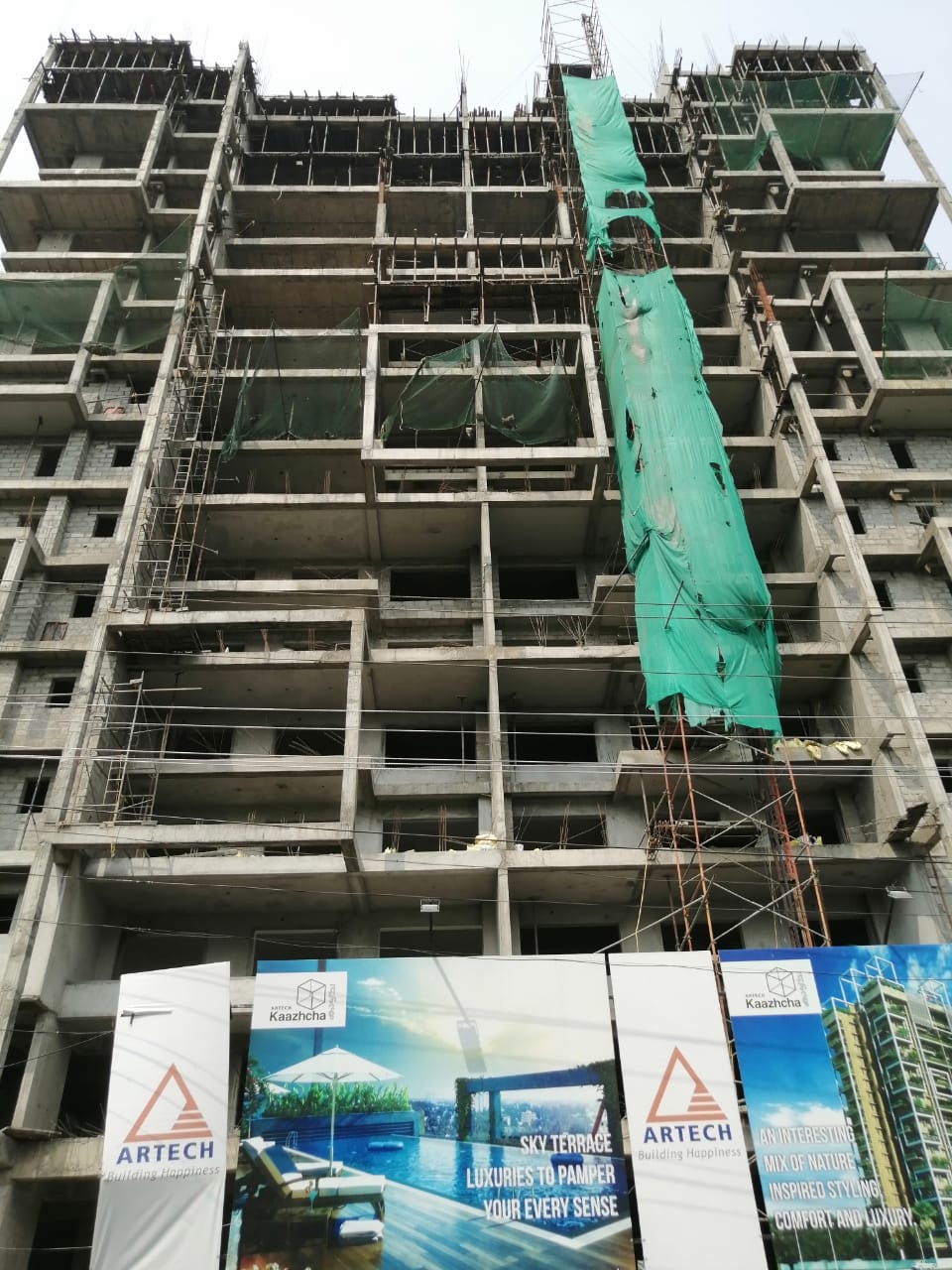

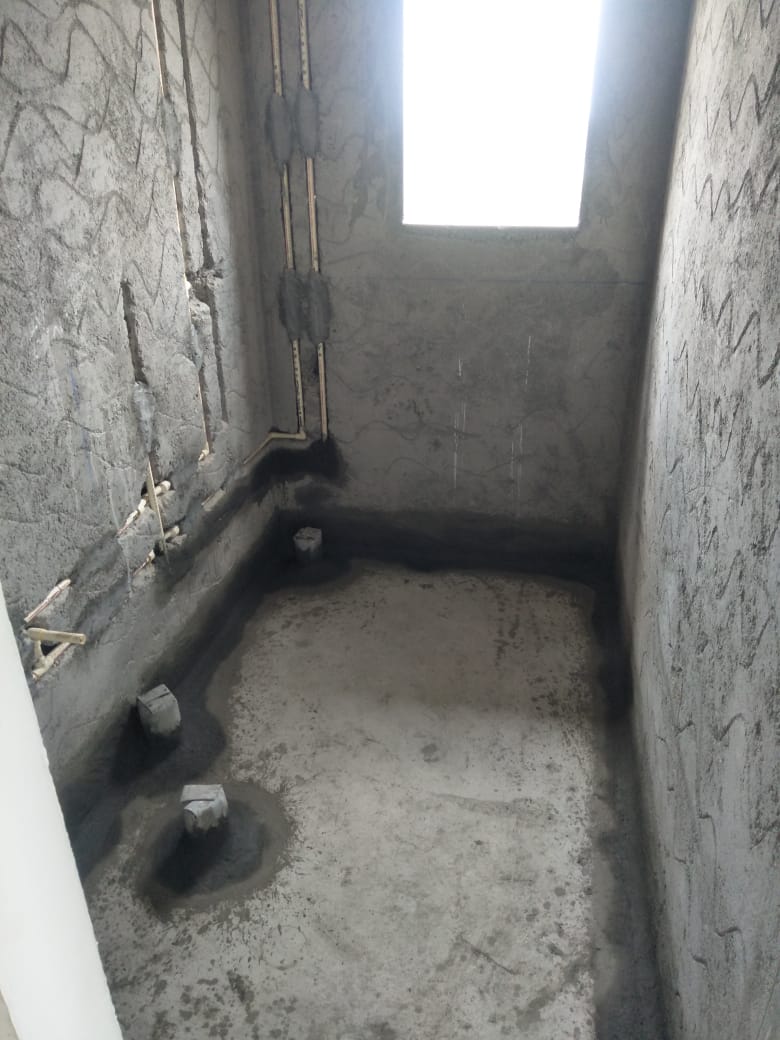

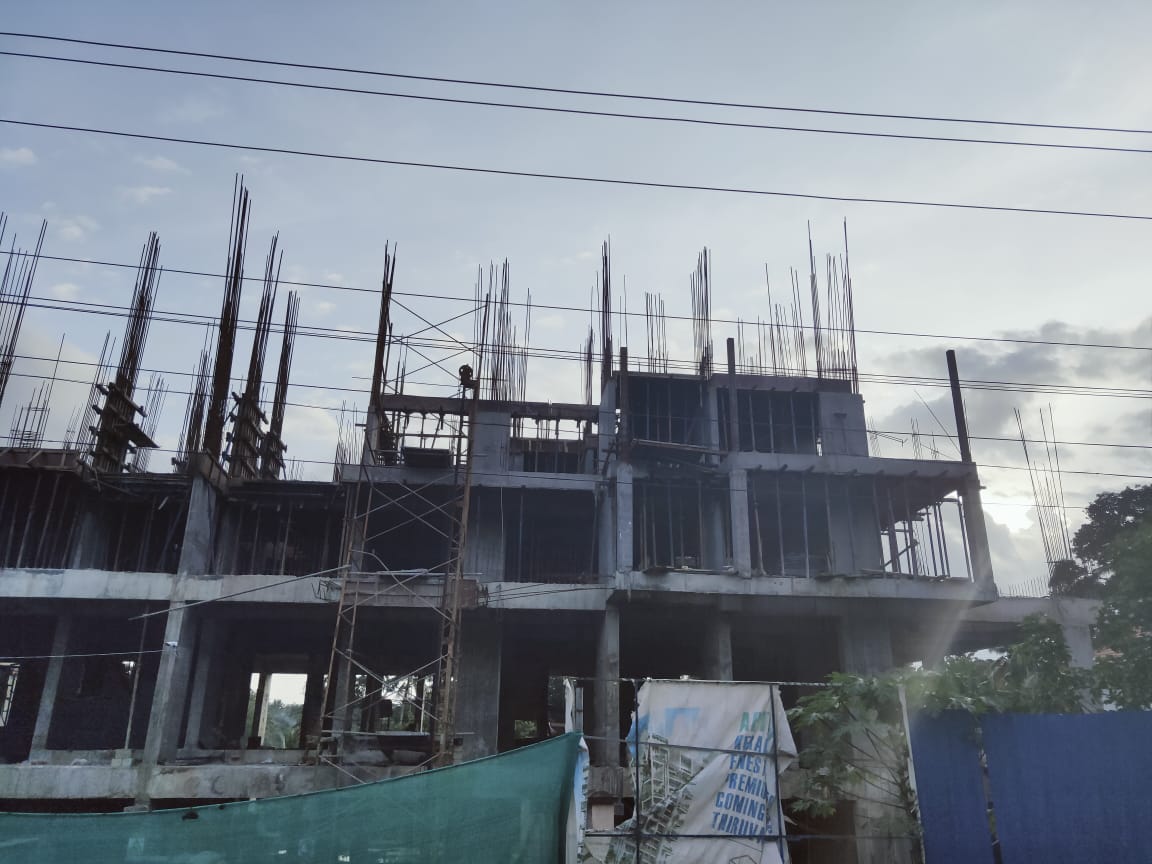

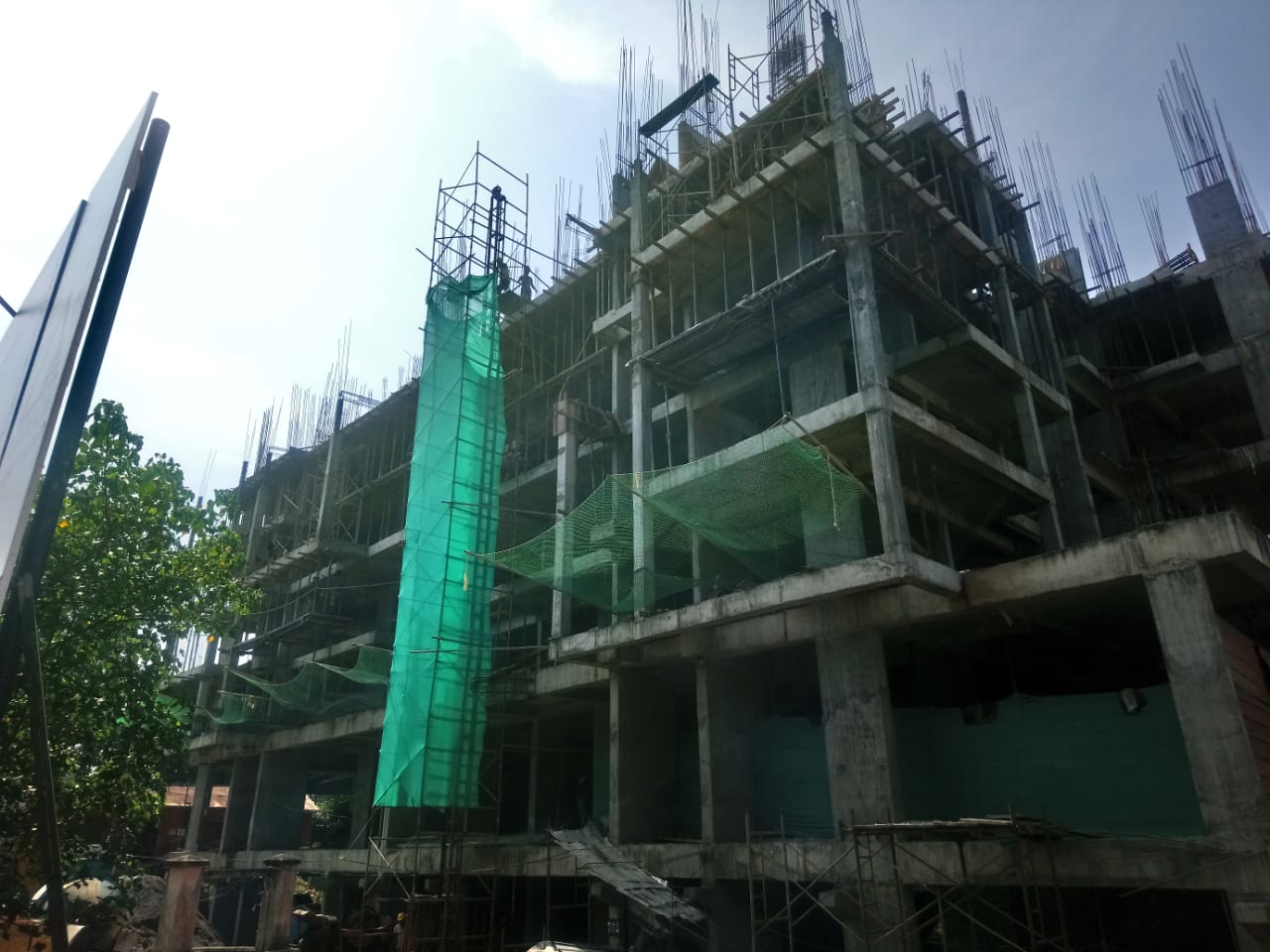

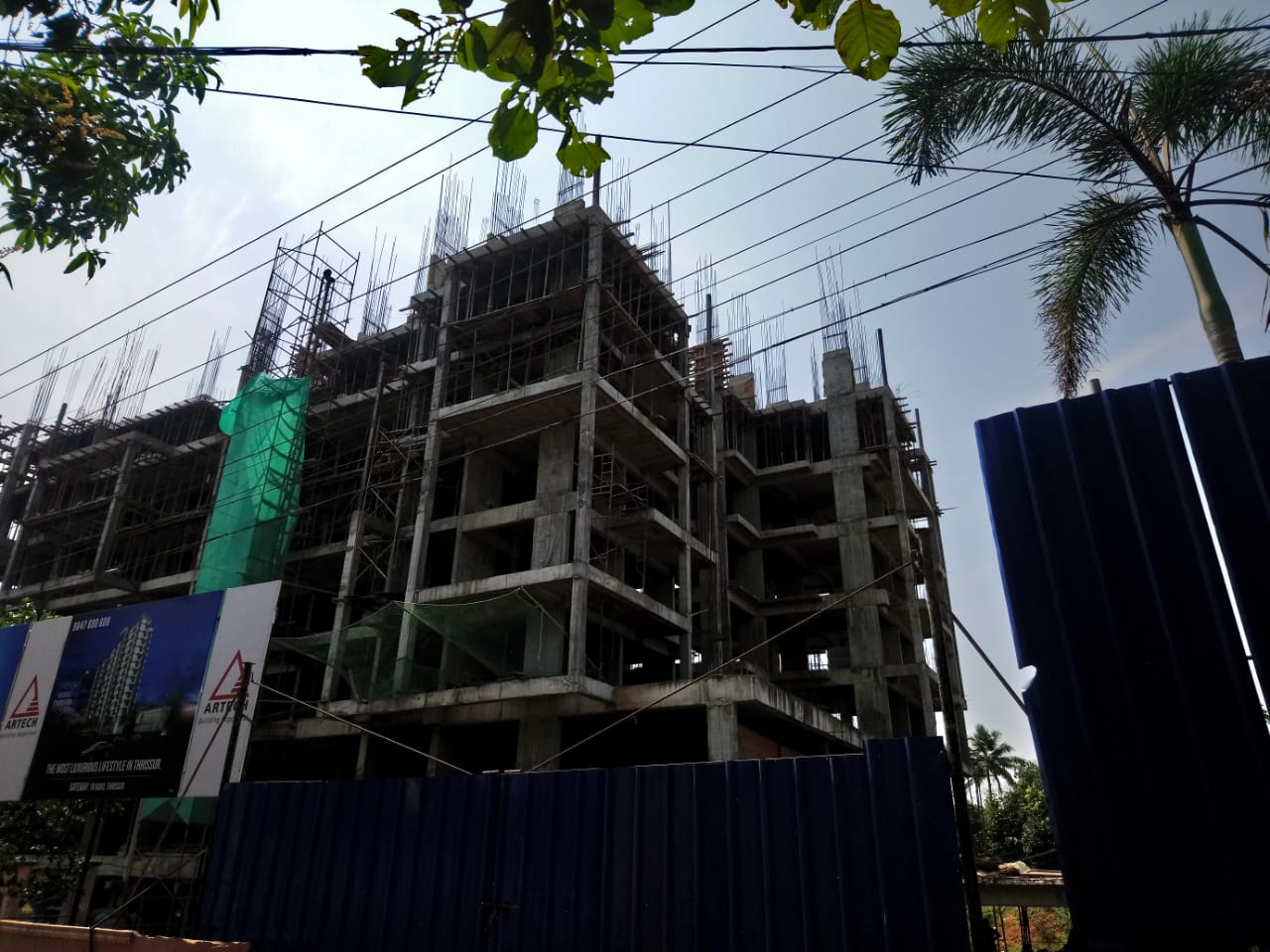

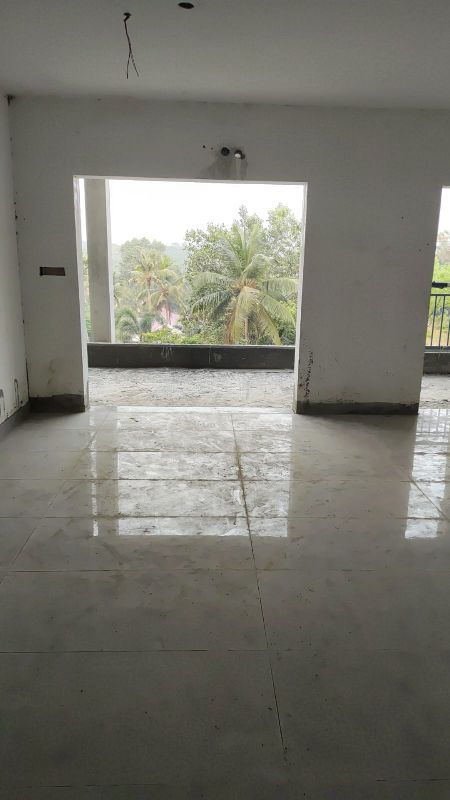

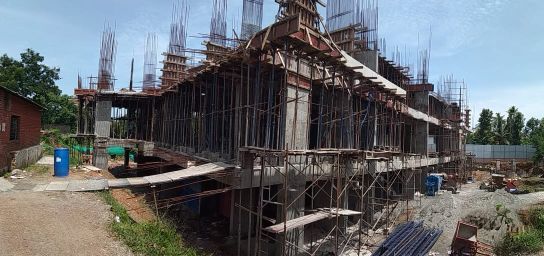

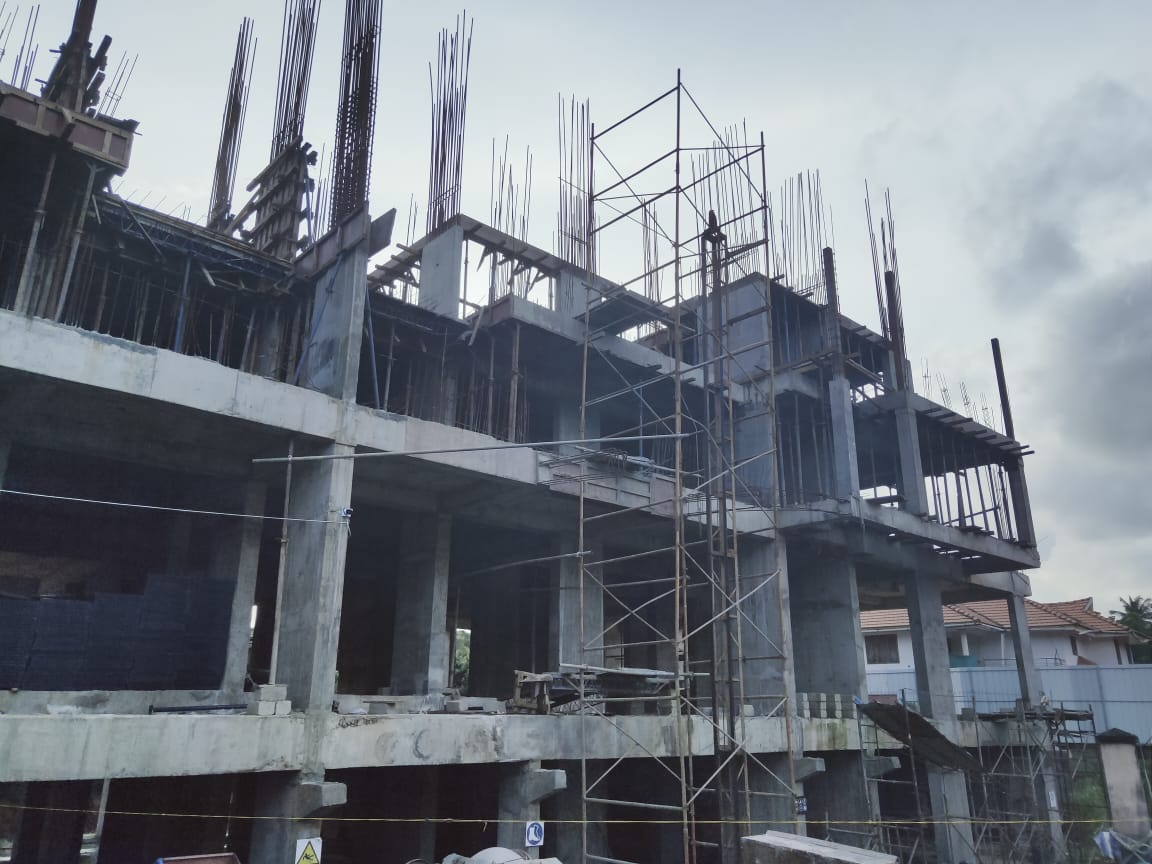

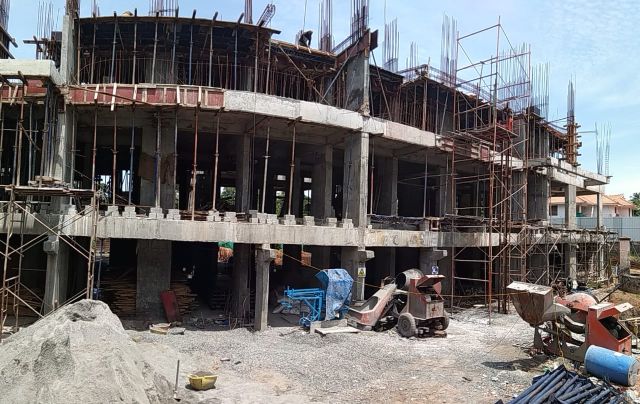

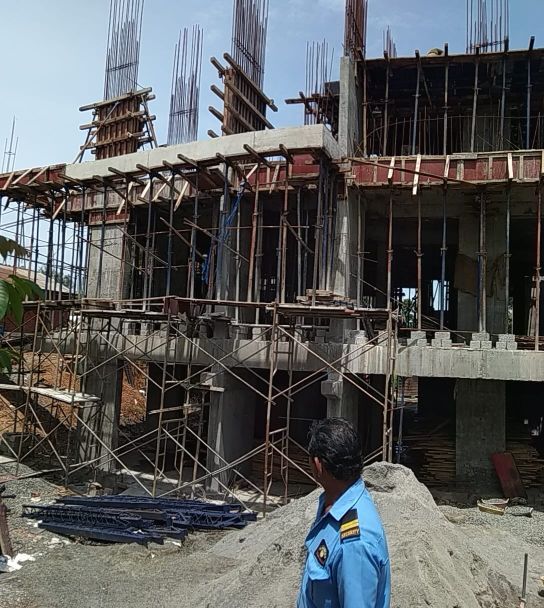

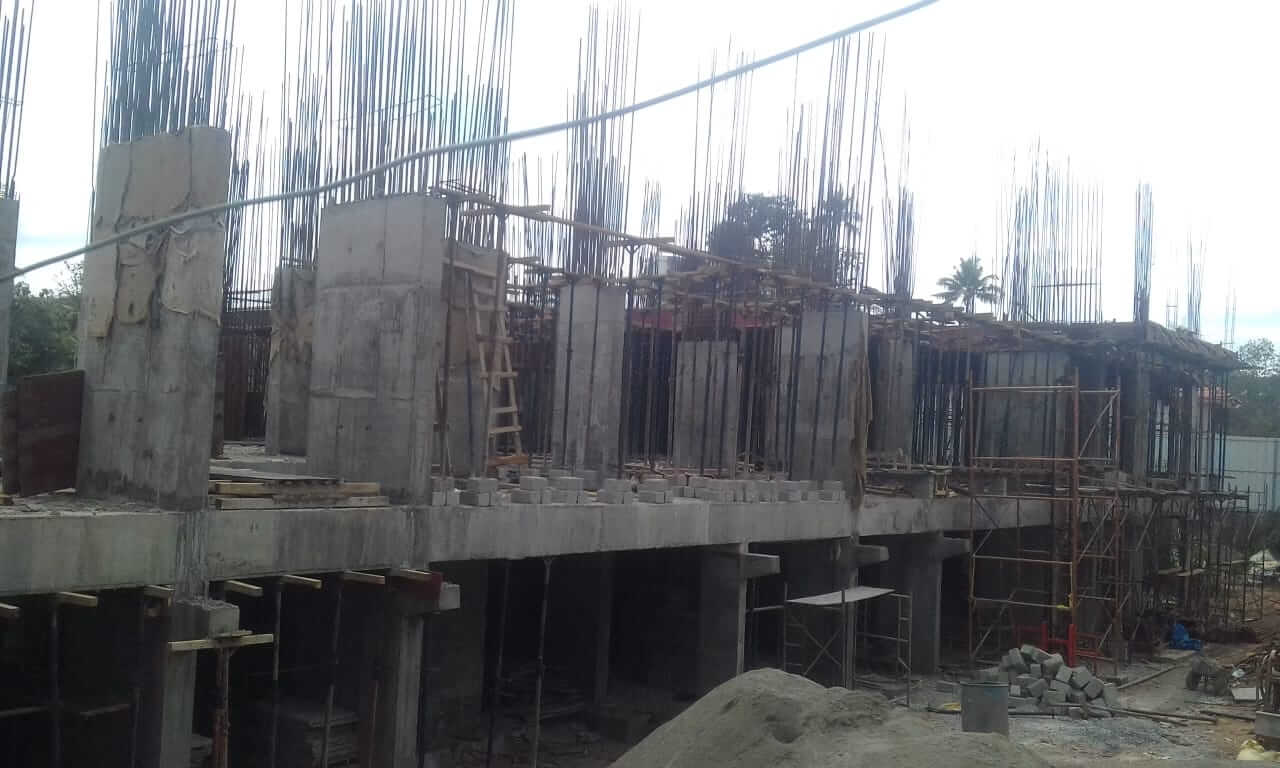

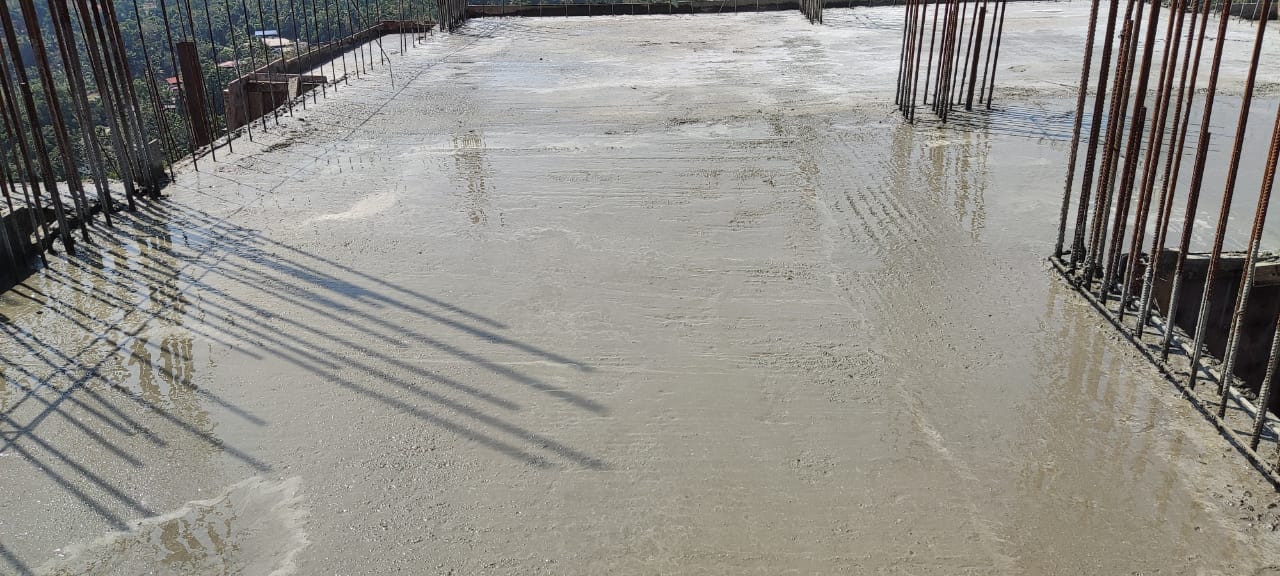

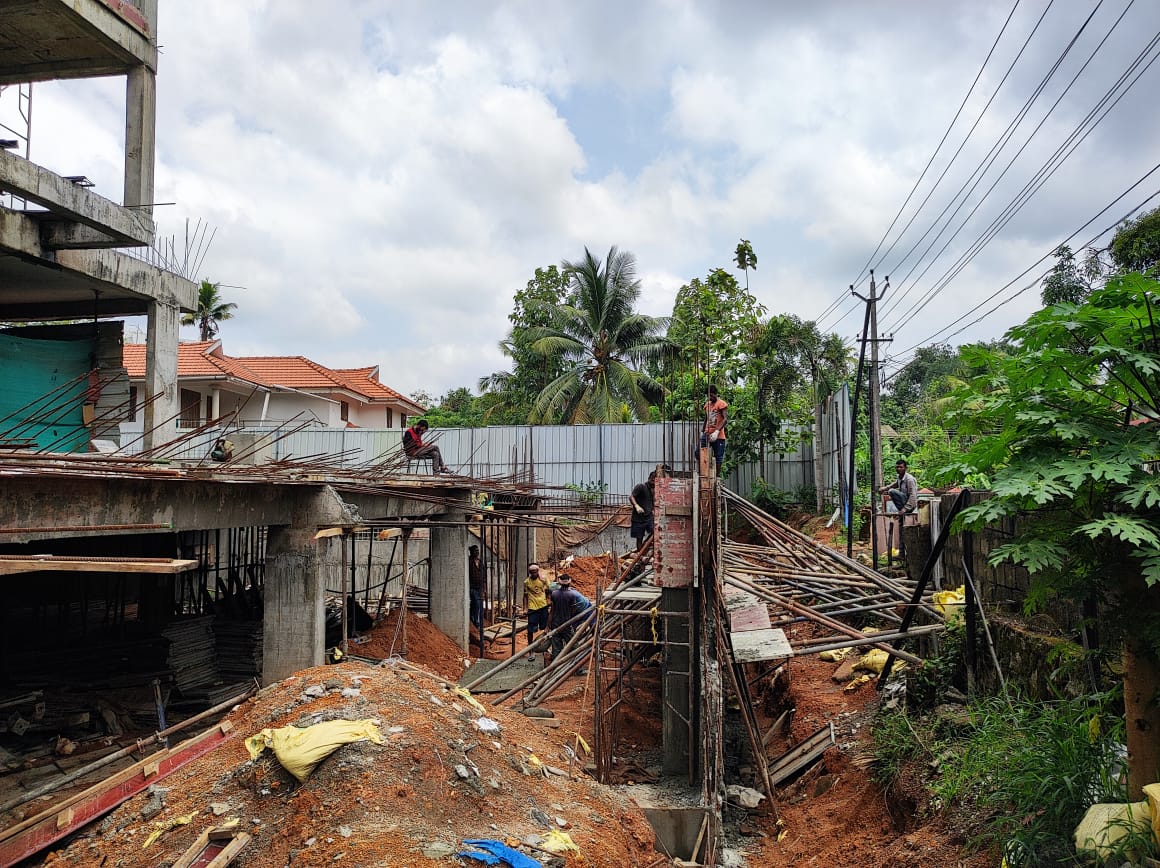

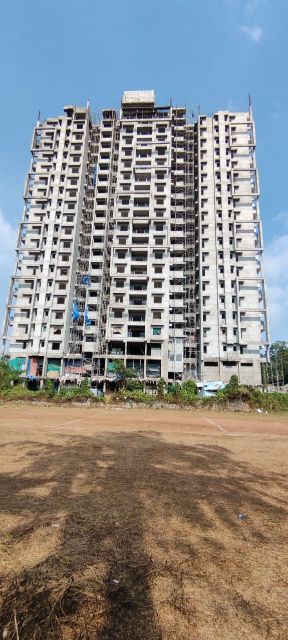

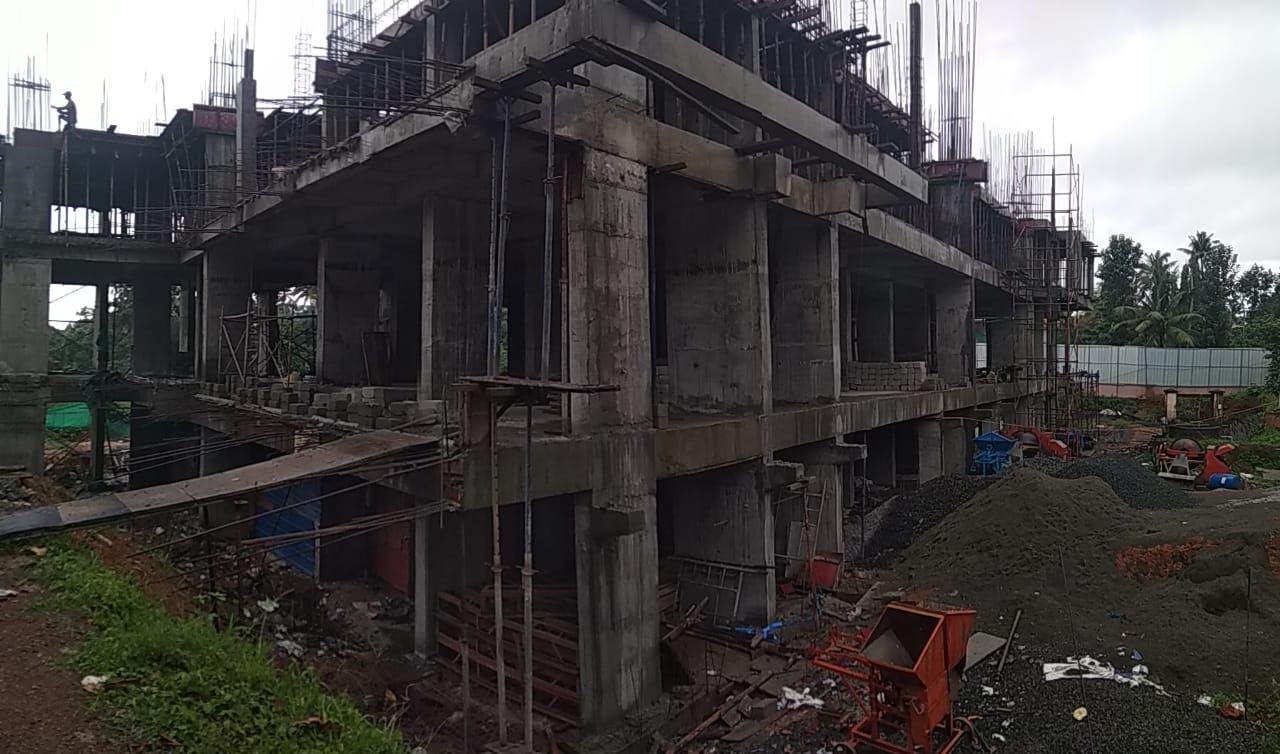

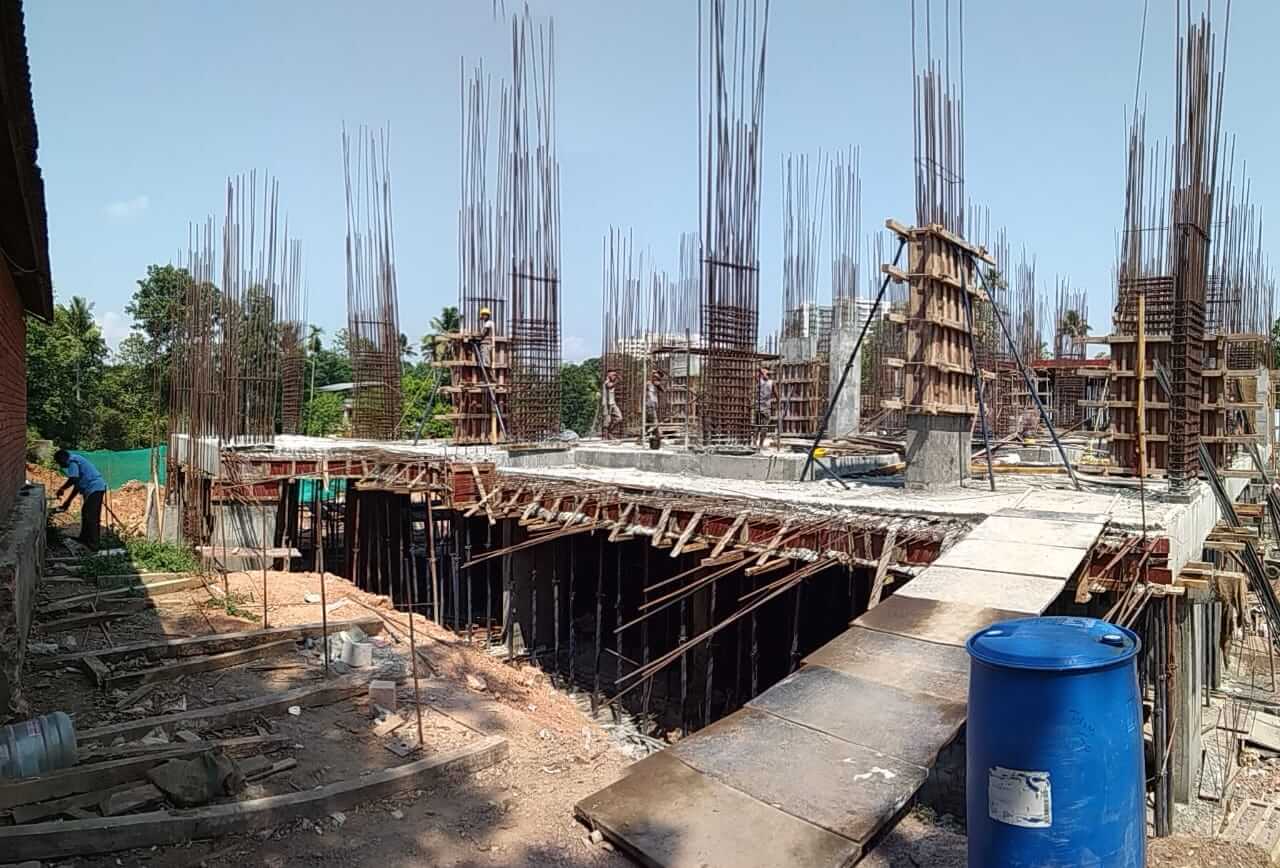

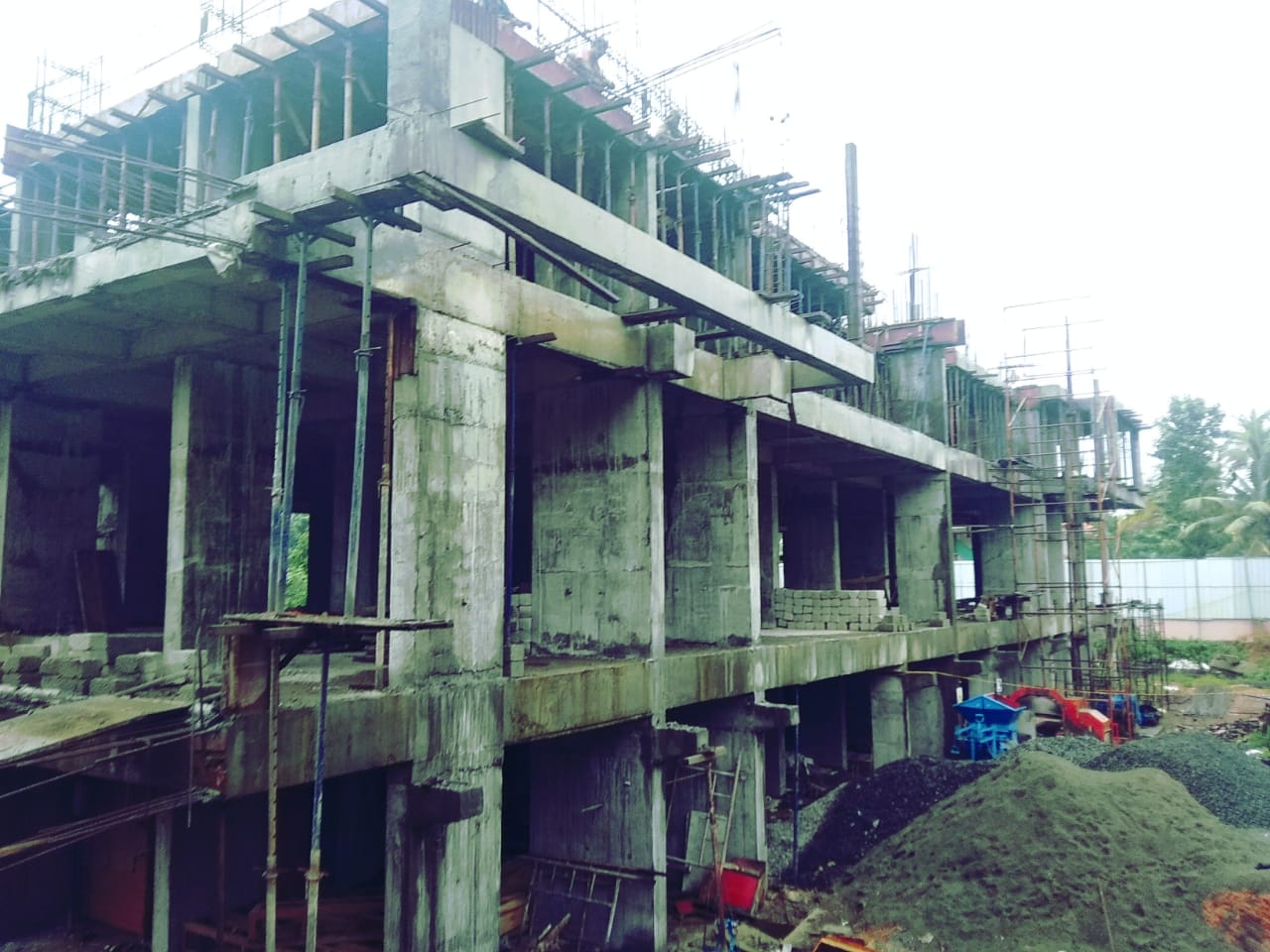

Artech Kaazhcha - PROGRESS

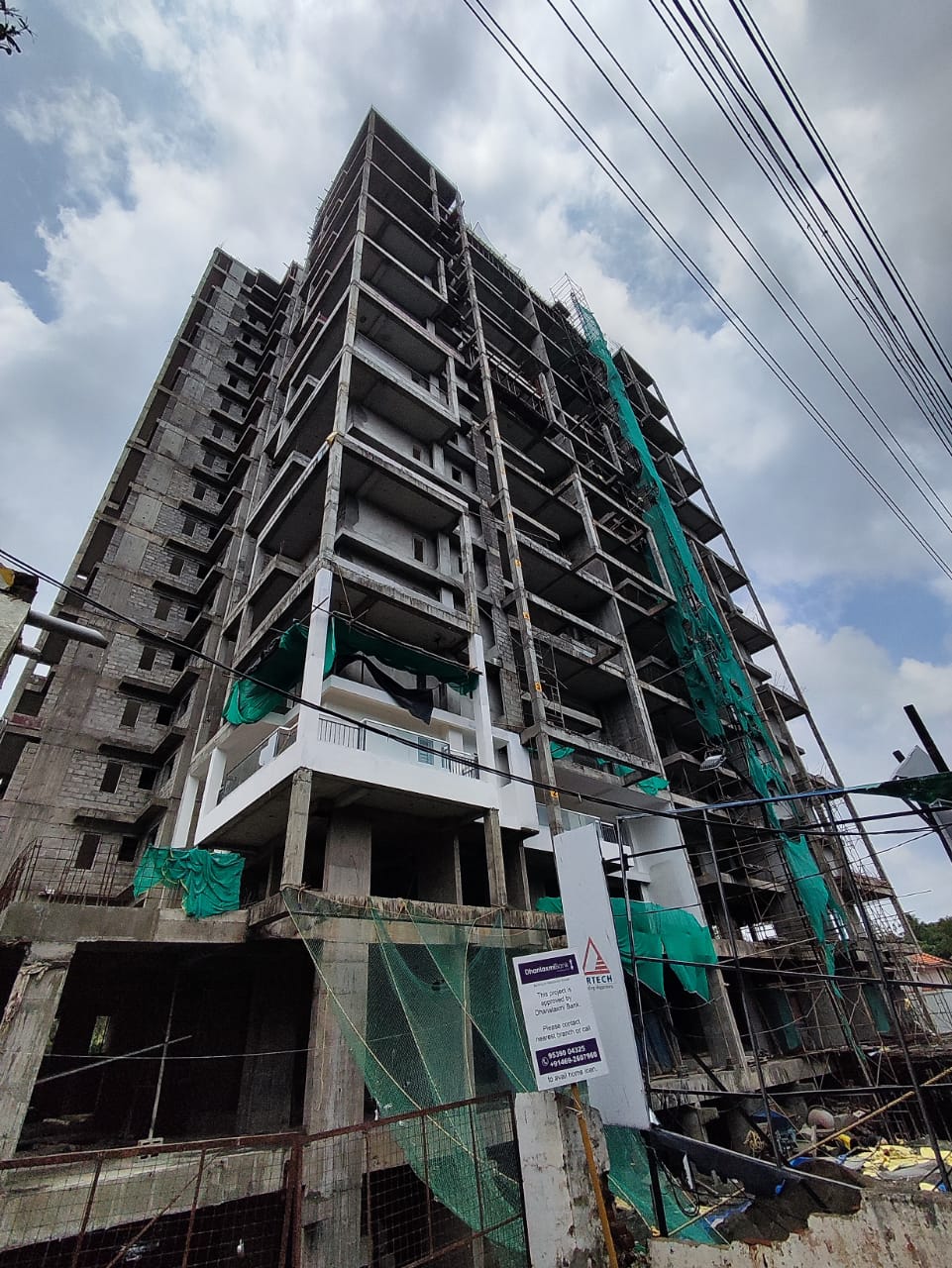

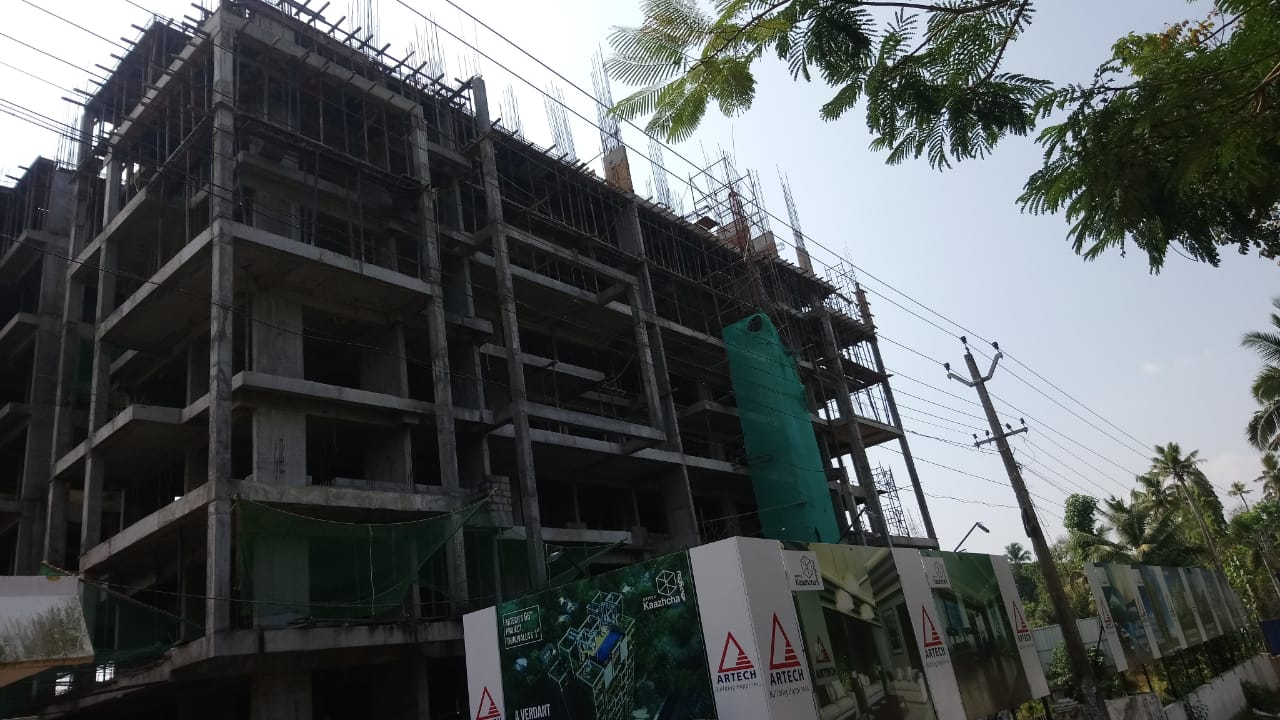

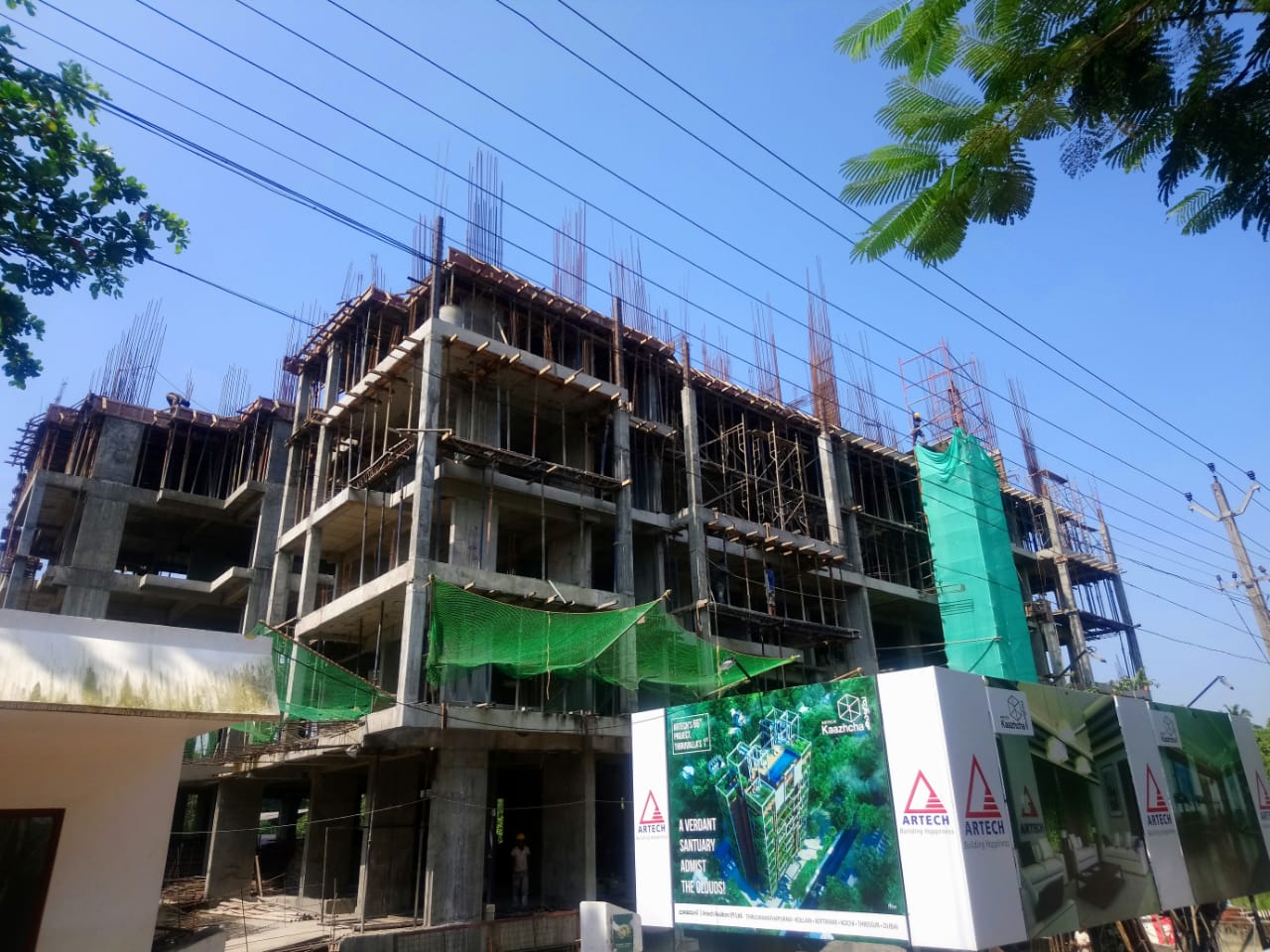

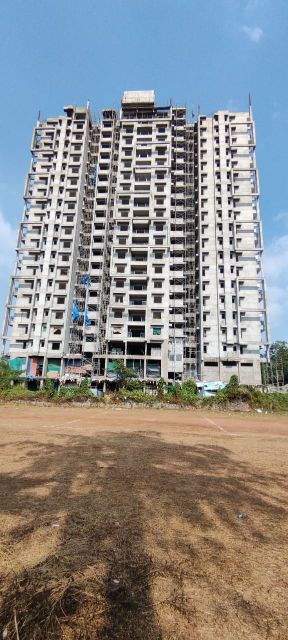

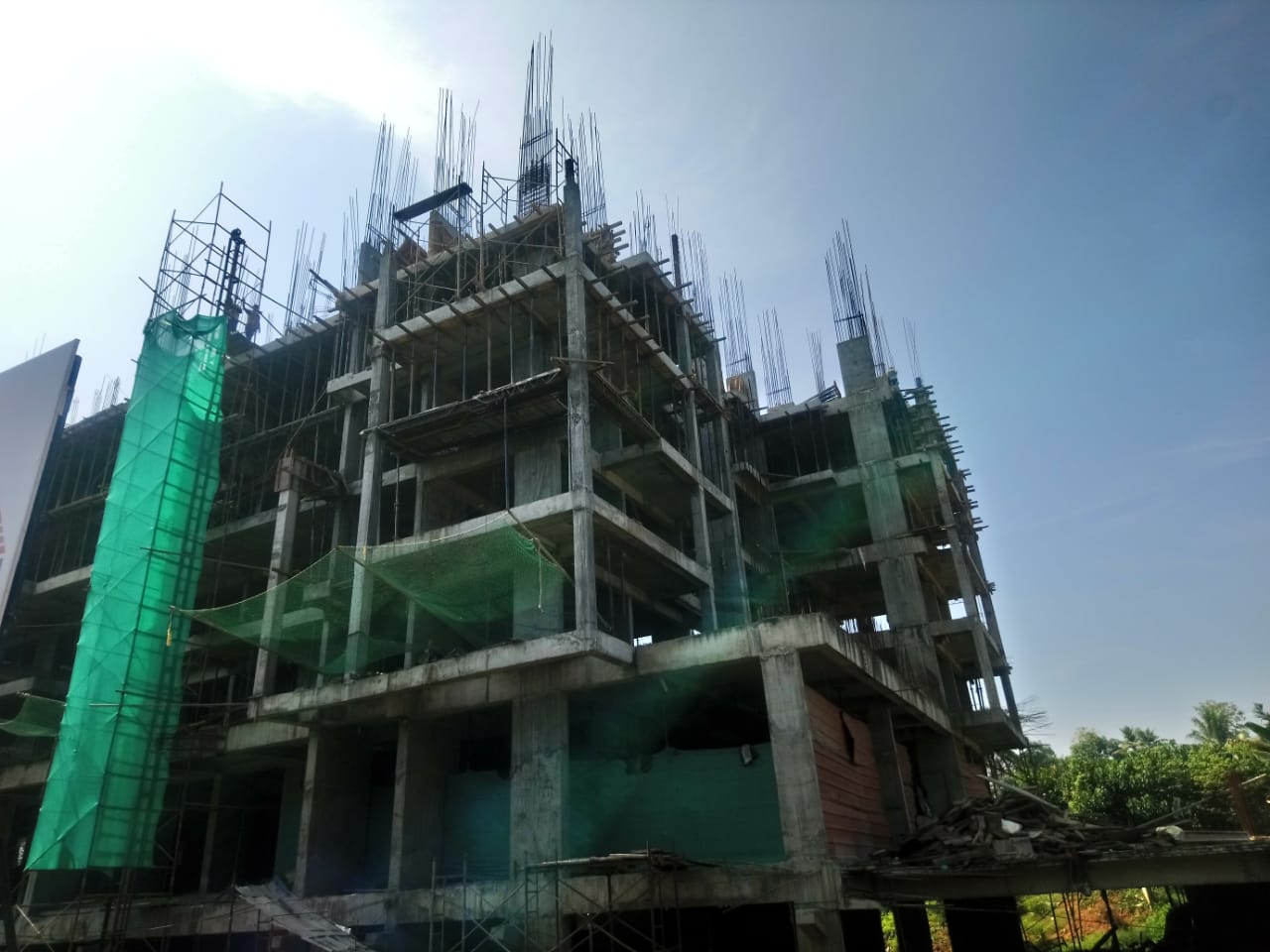

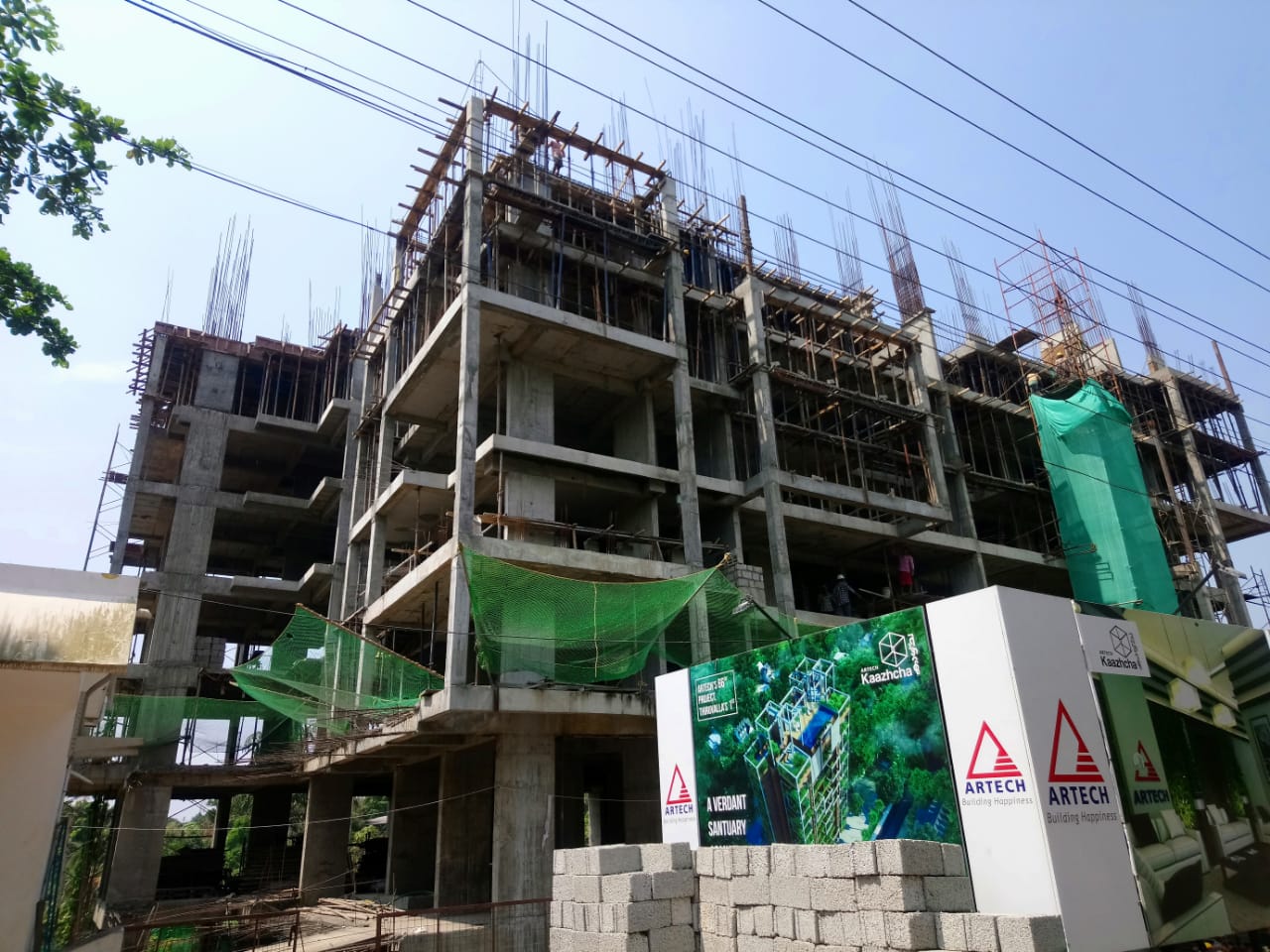

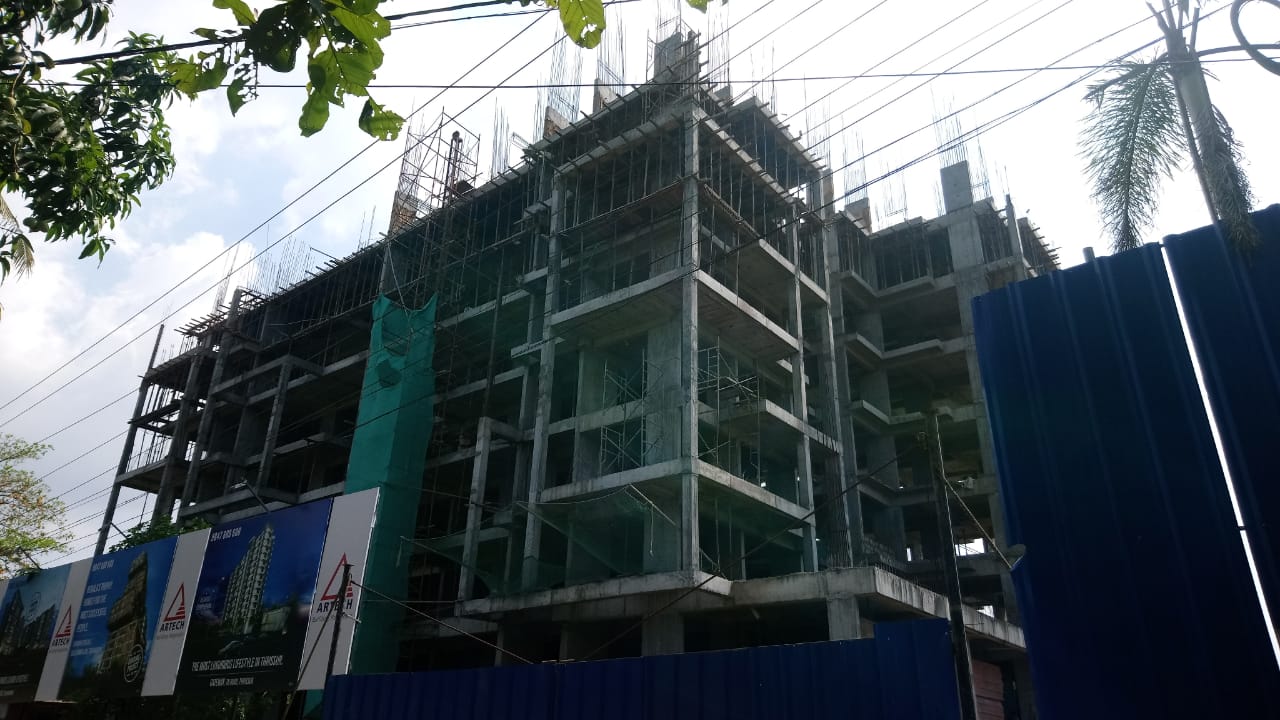

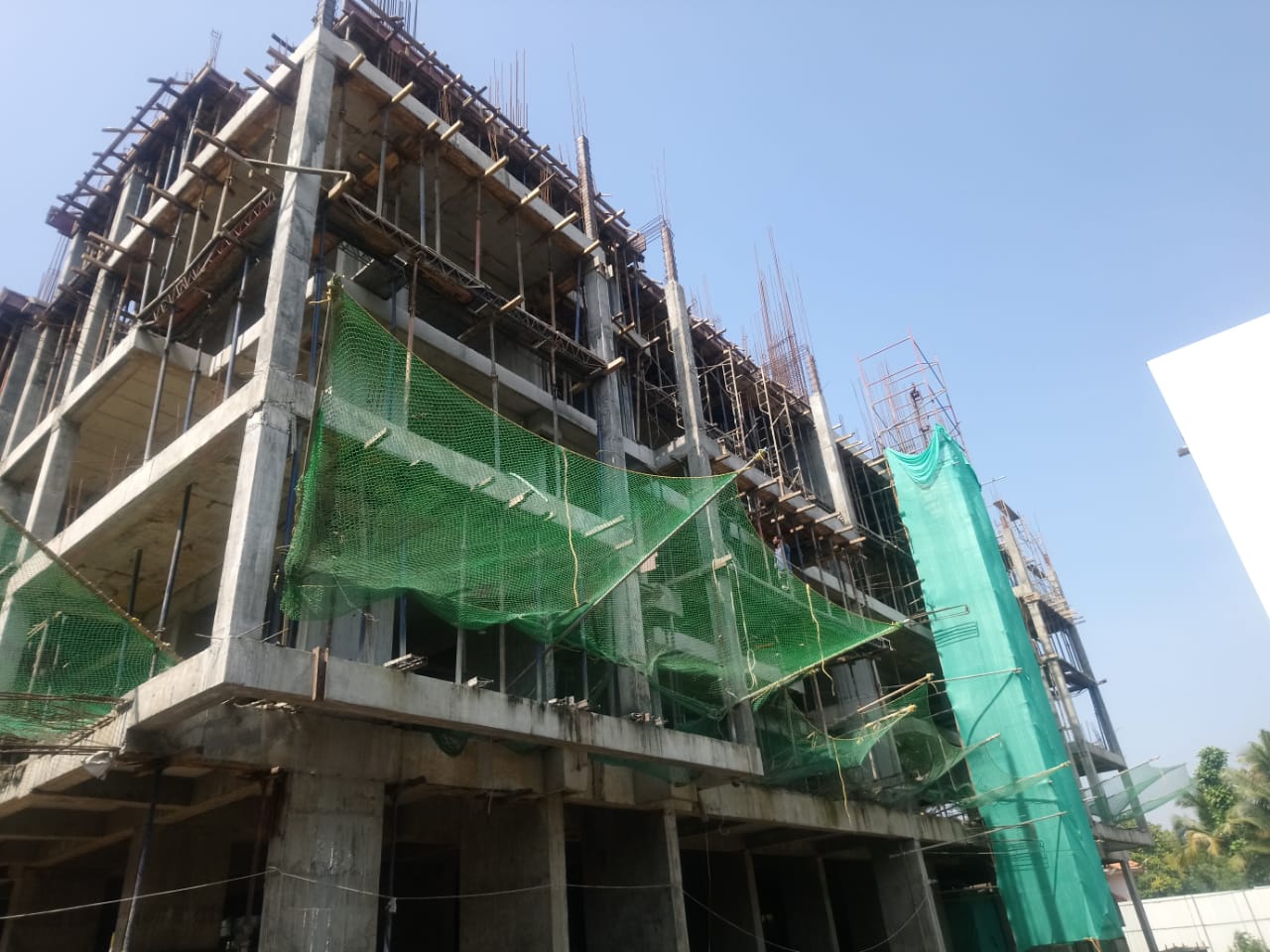

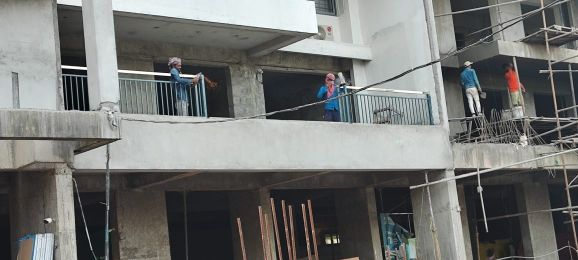

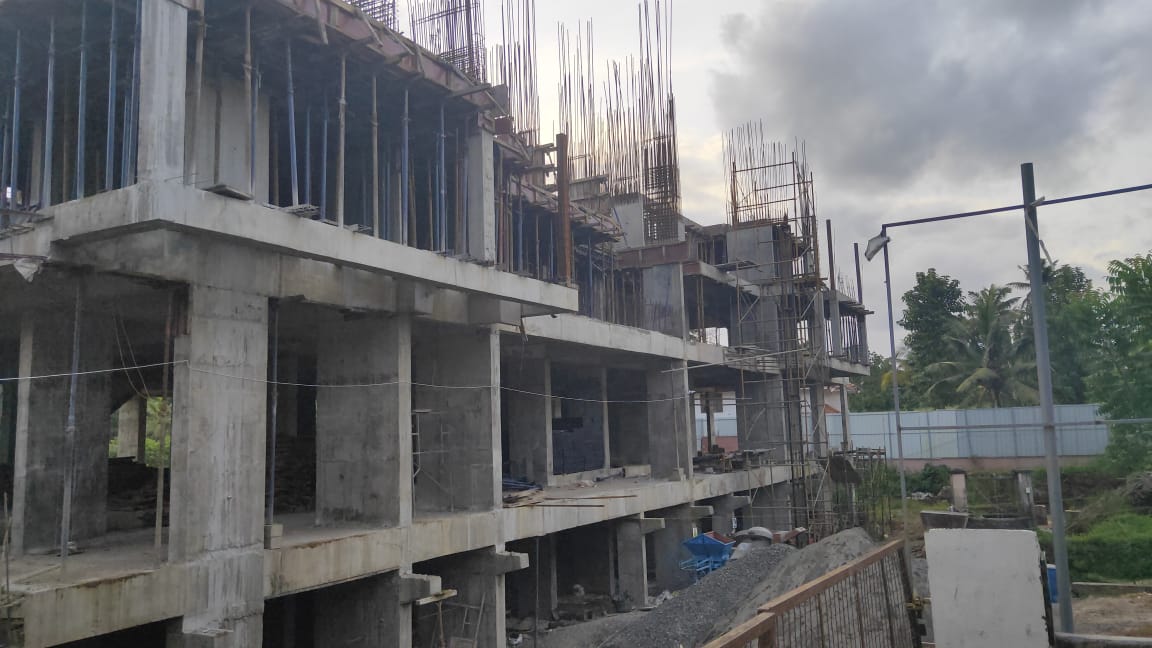

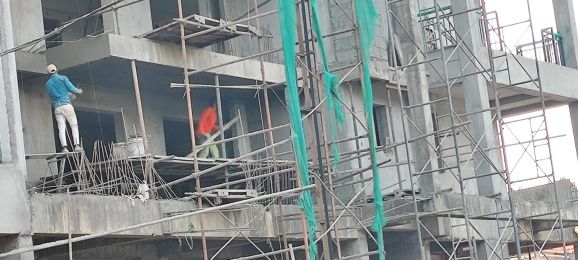

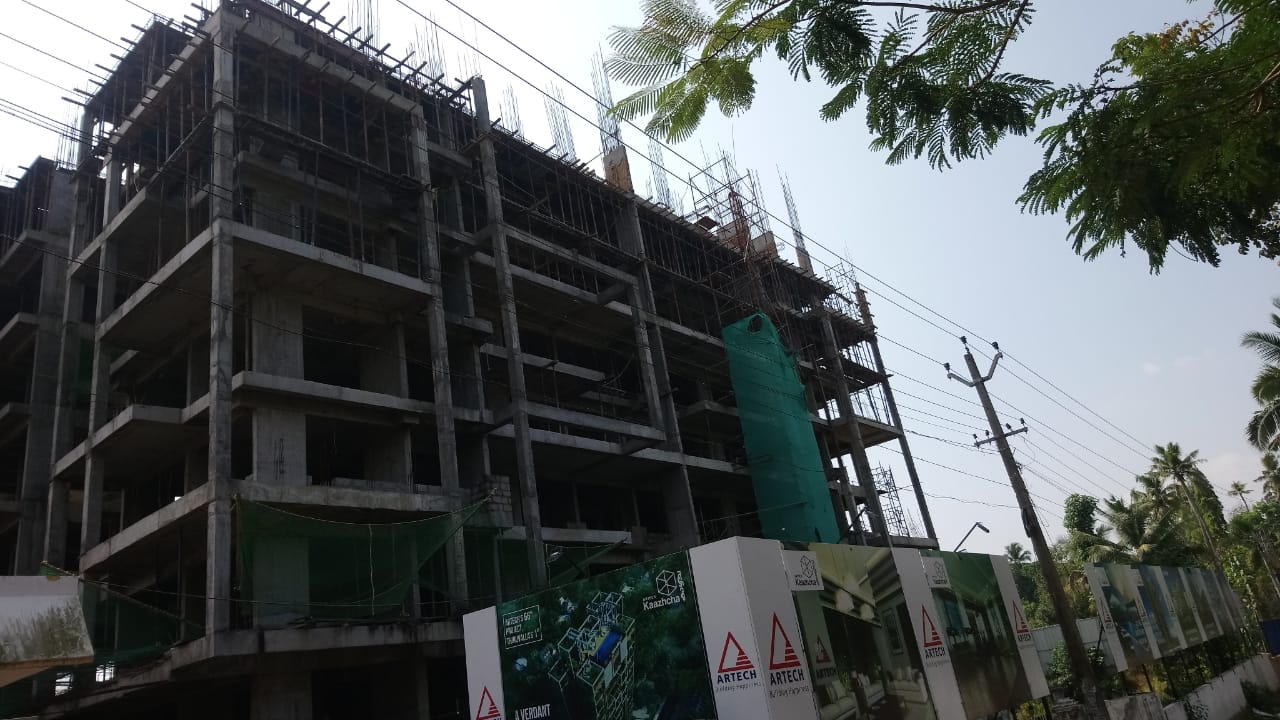

Work status as on 08-03-2023, we have completed the following.

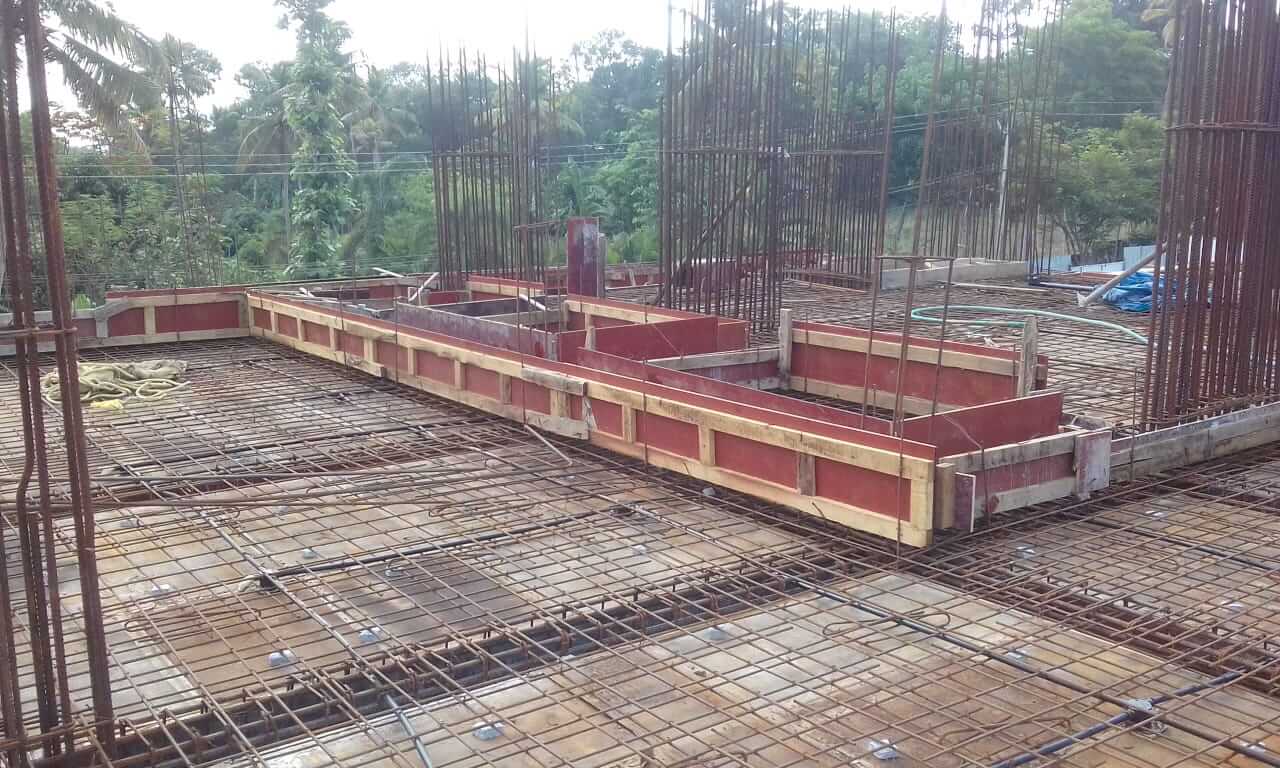

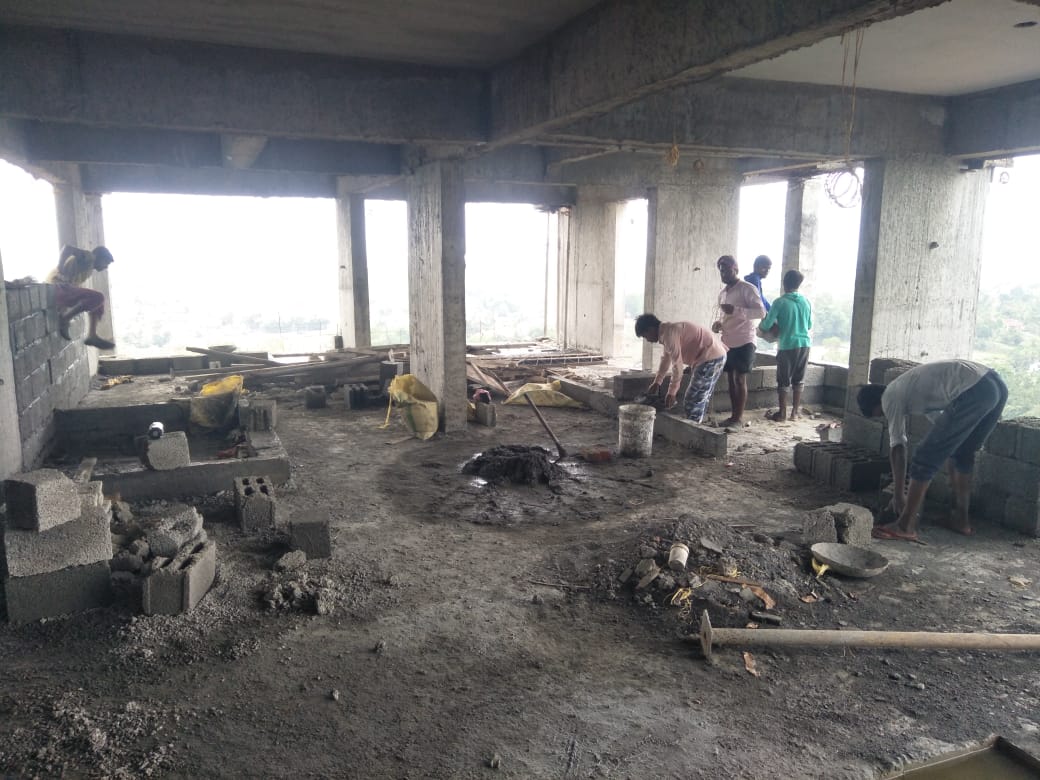

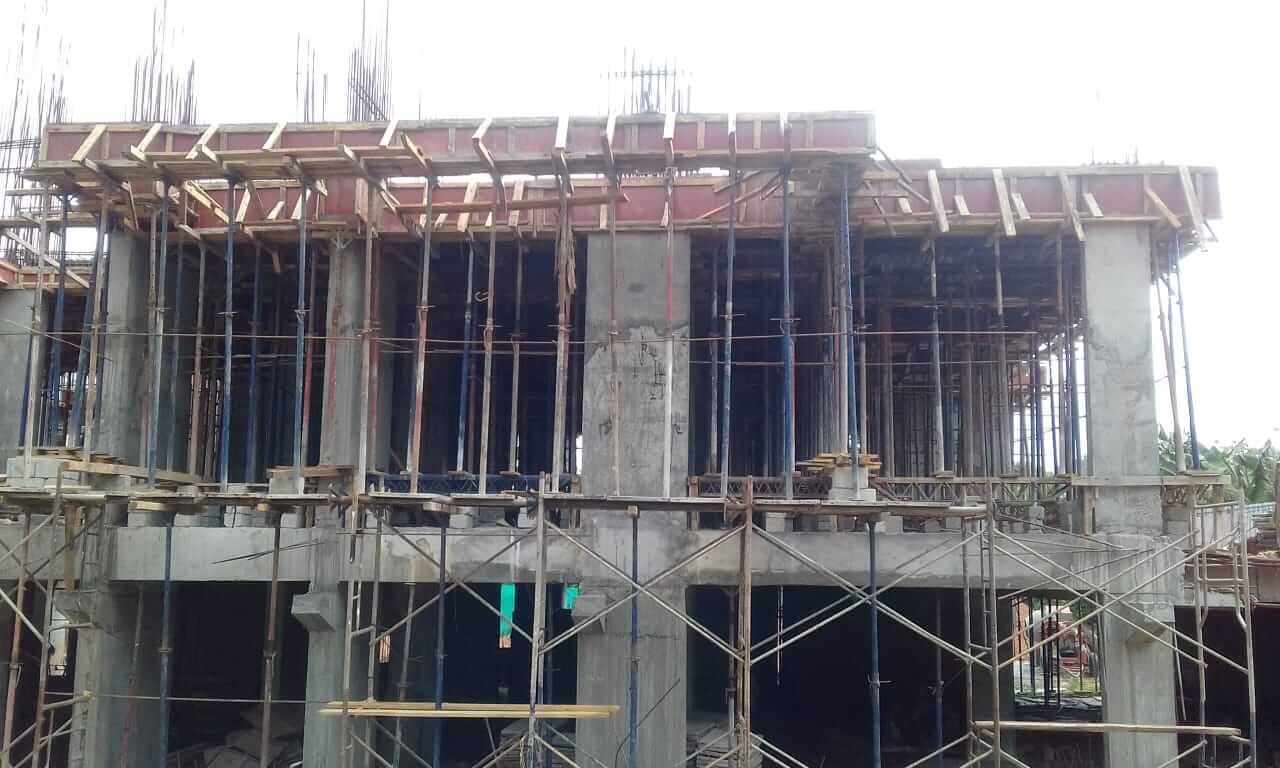

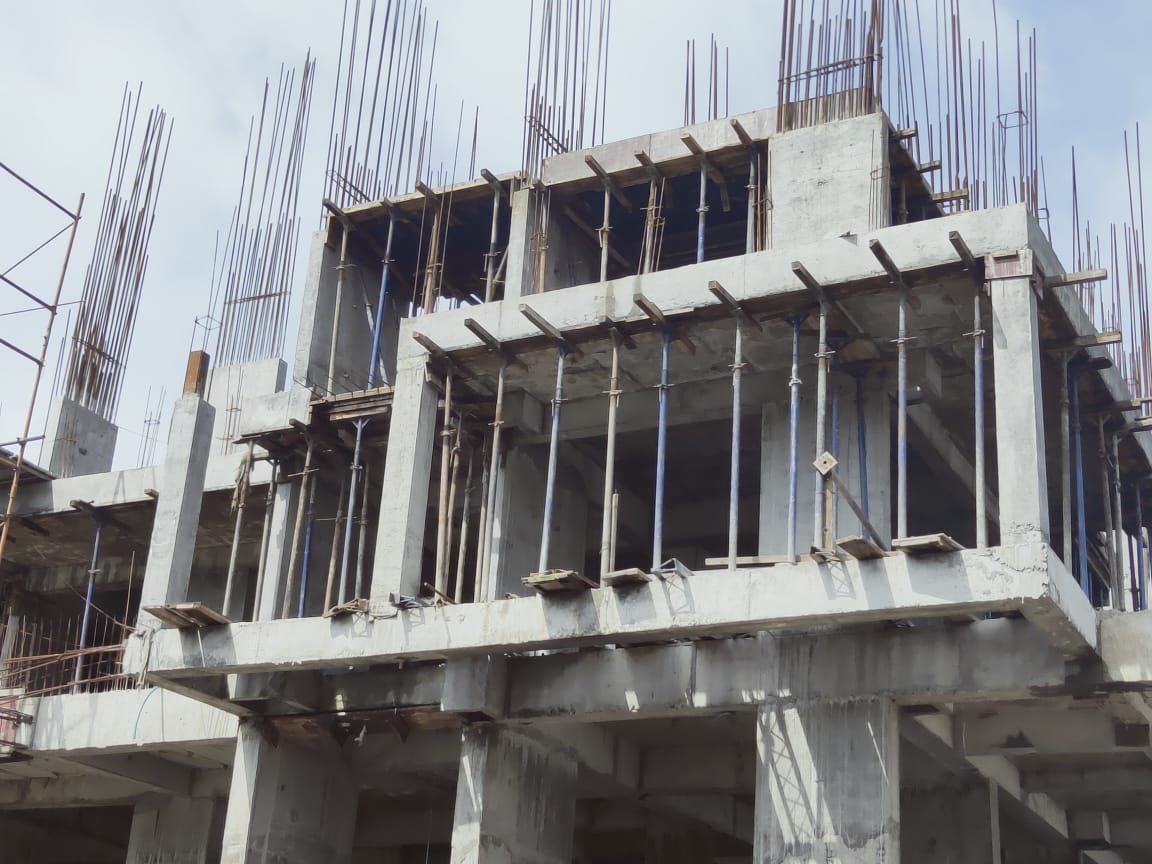

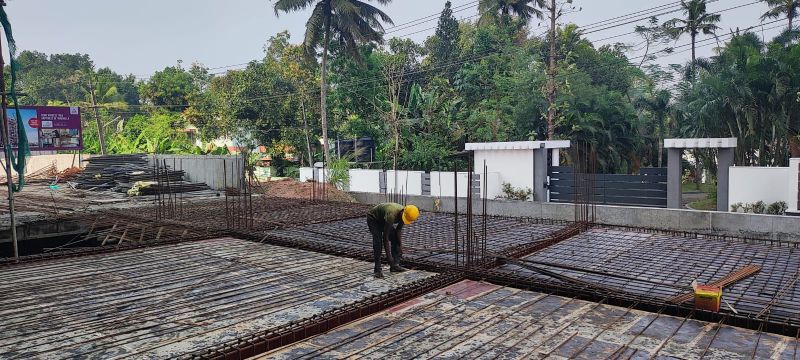

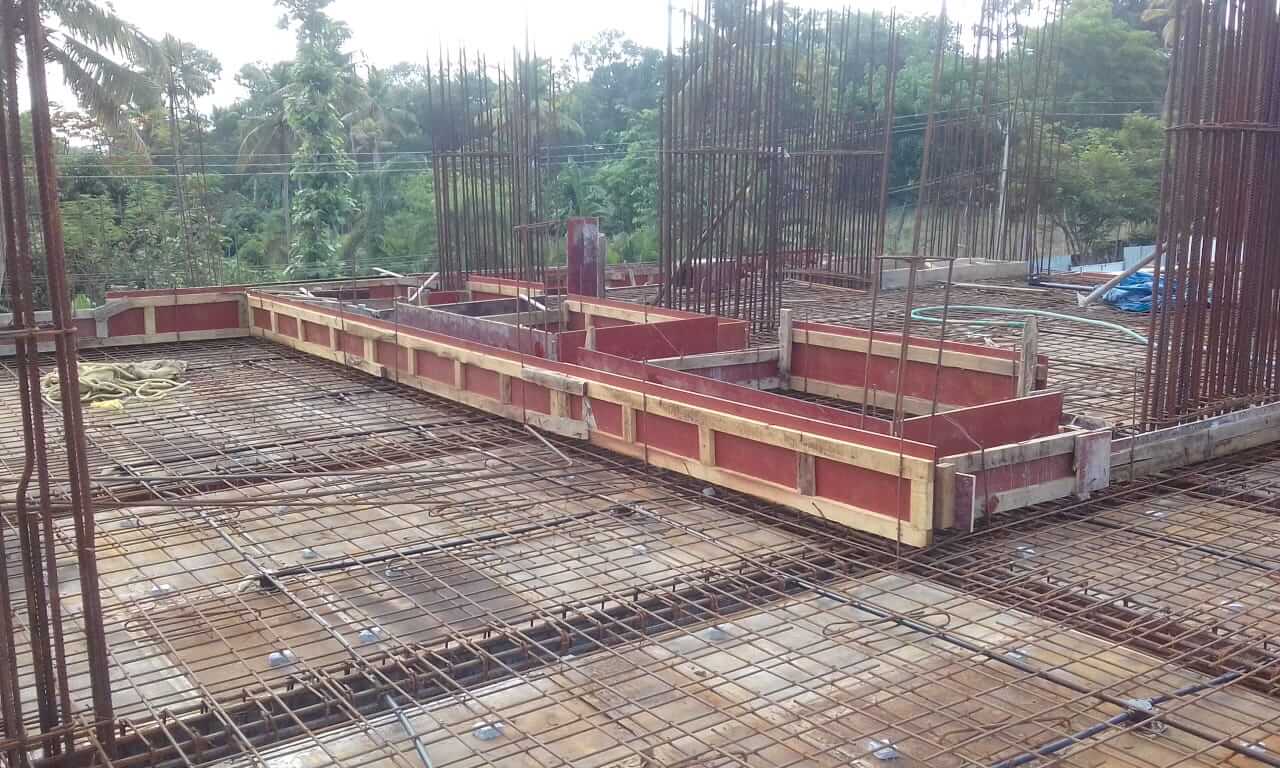

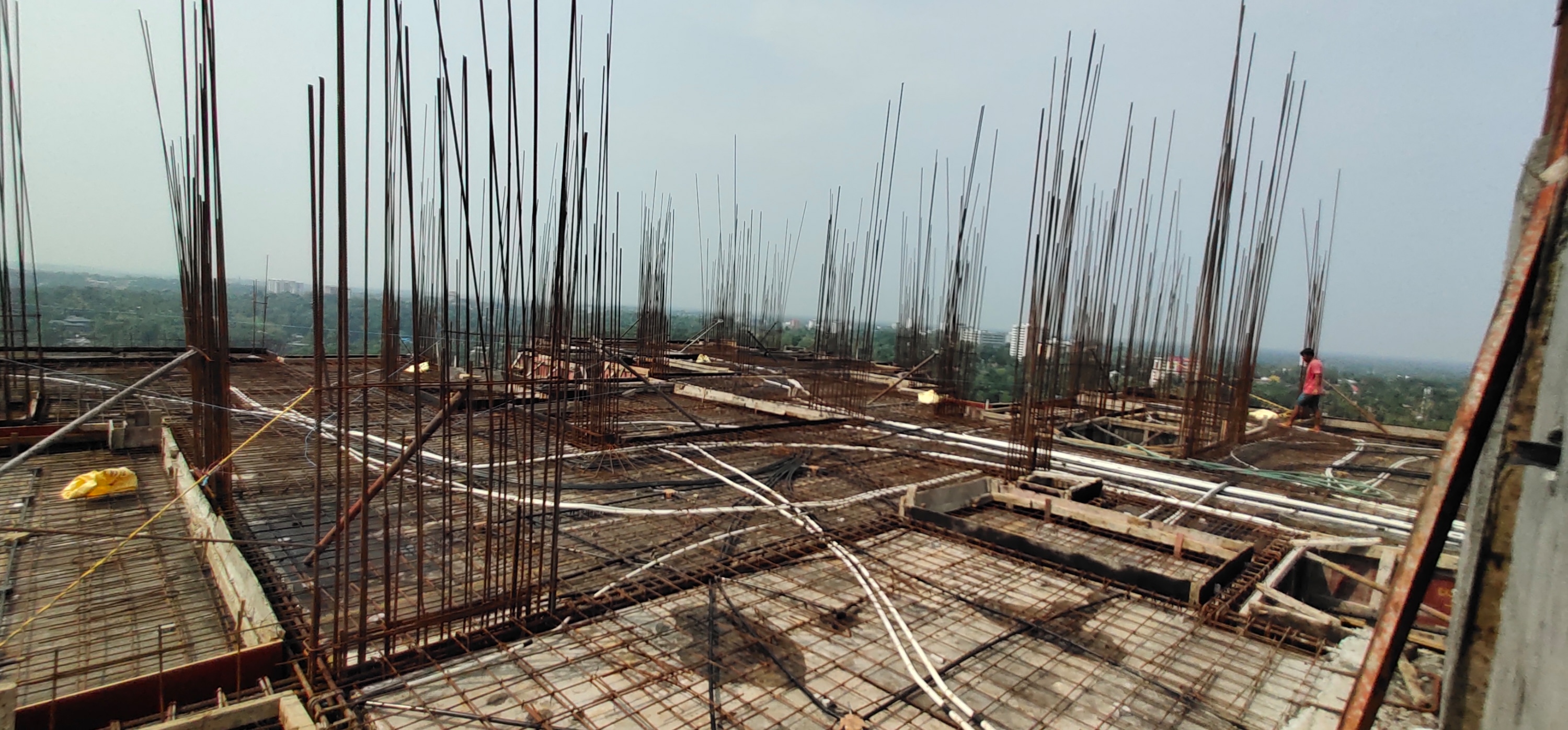

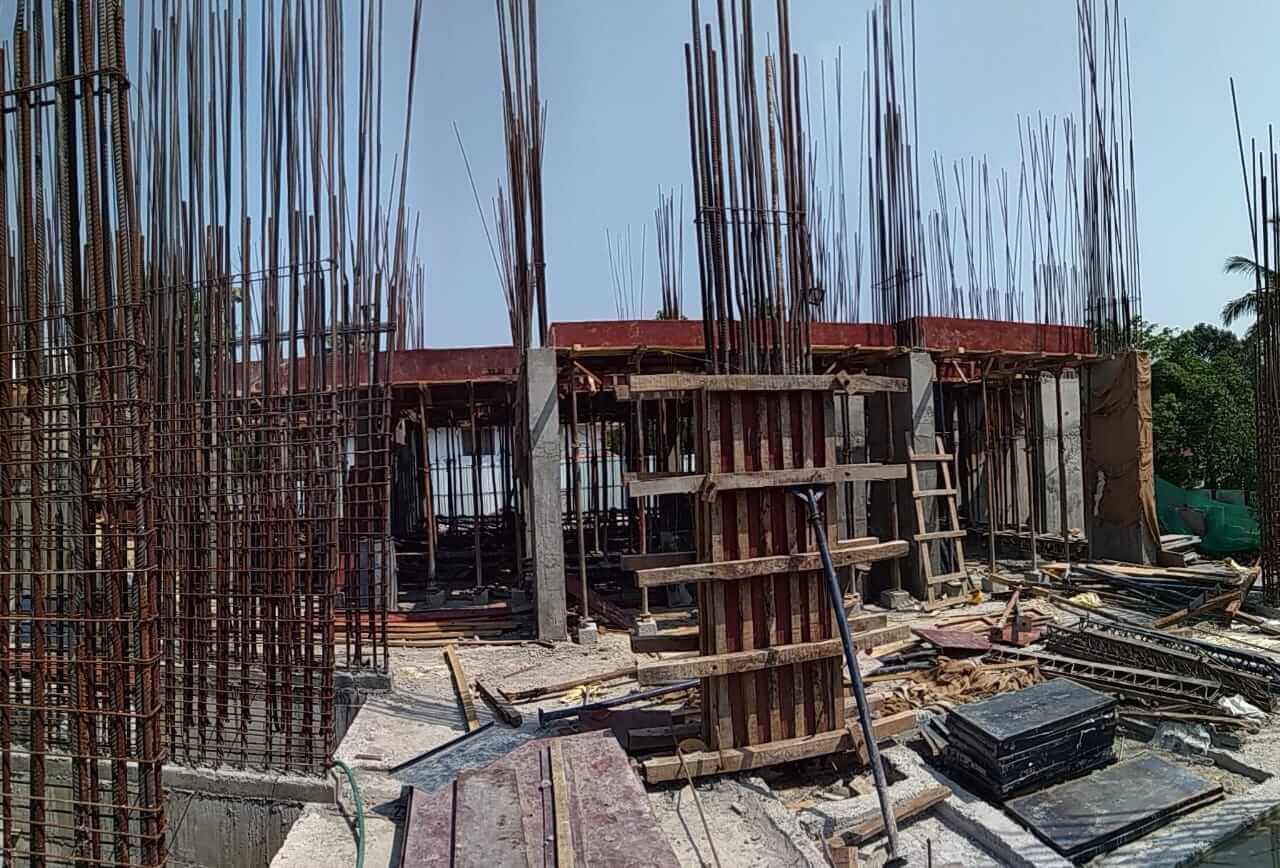

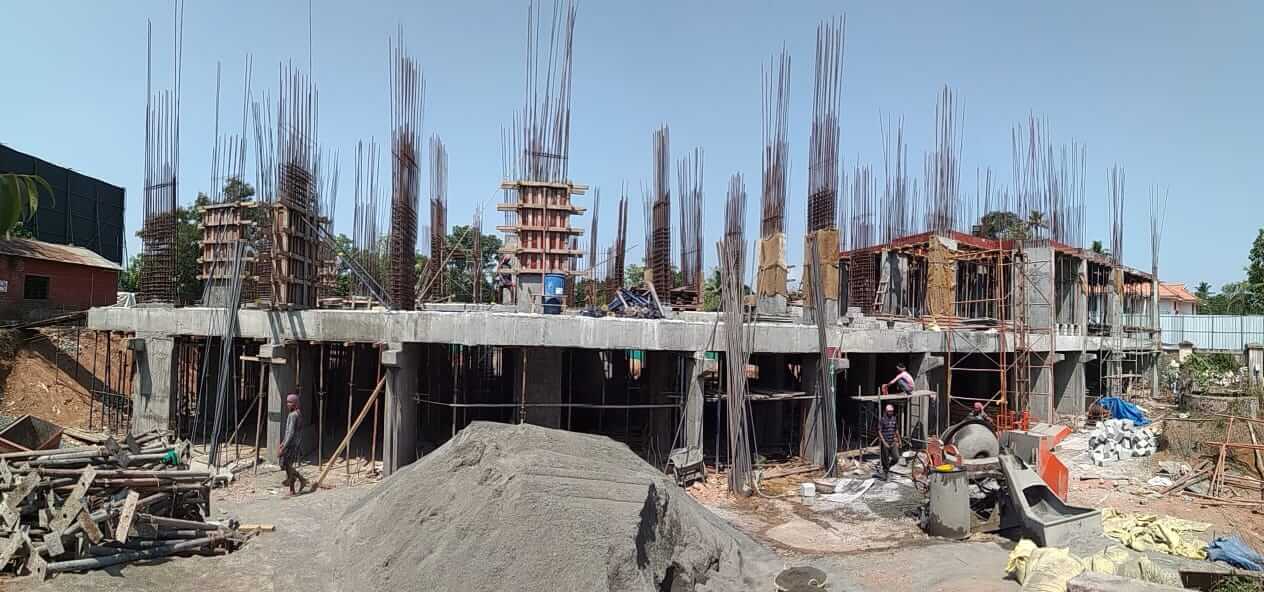

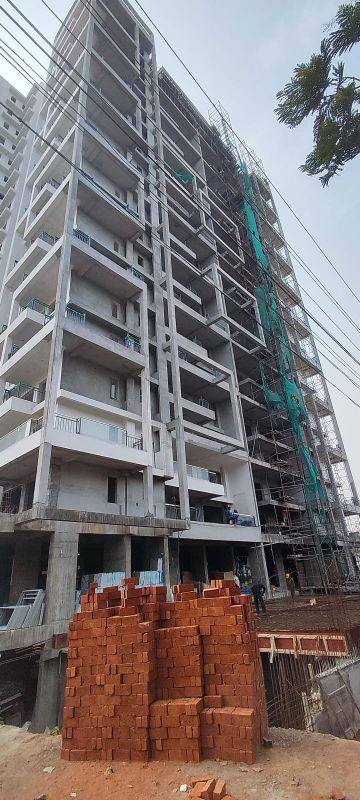

  • Structural Works – Pile cap – 82% completed, slab – 95% completed, swimming pool base slab completed, swimming pool wall – 40% completed, ramp completed, retaining wall – 25% completed

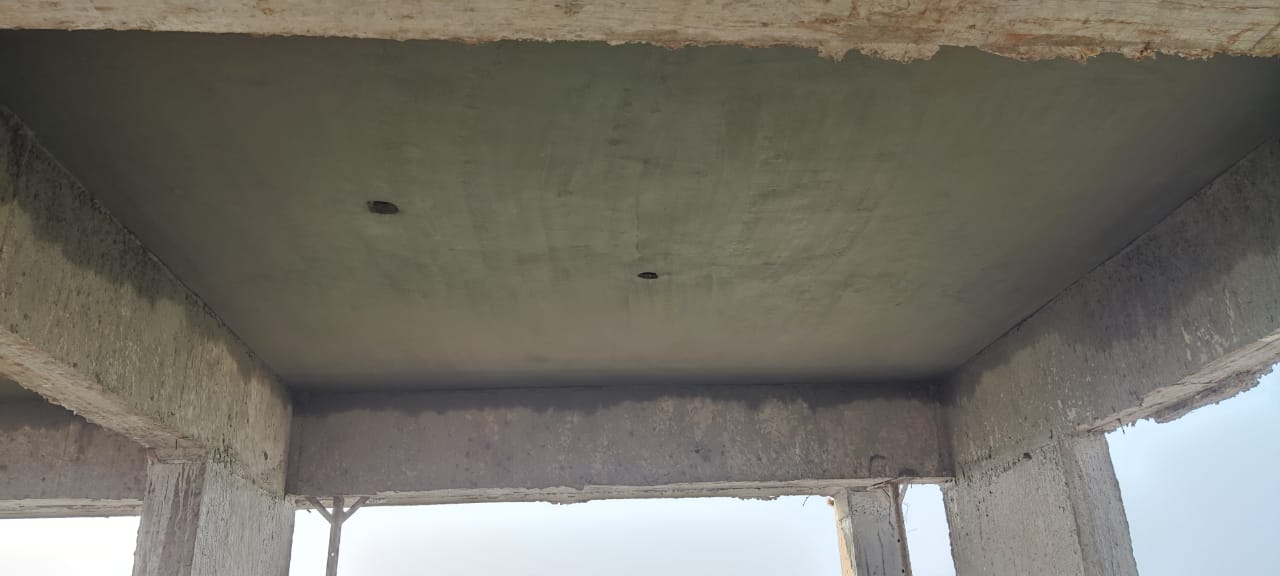

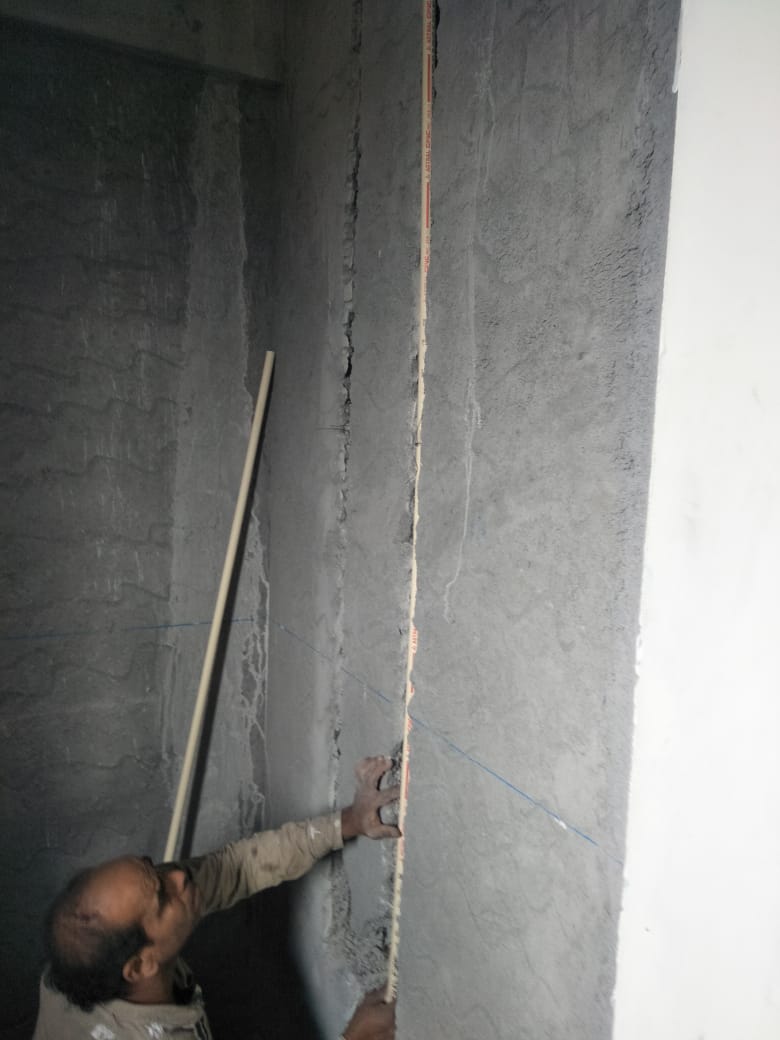

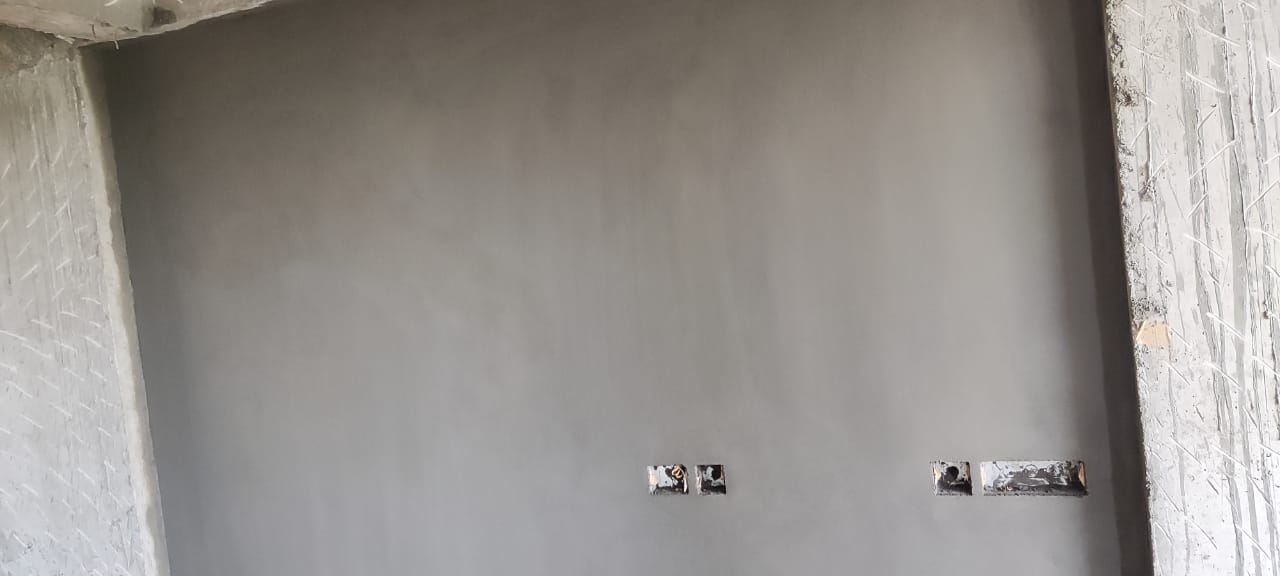

  • Civil Works – Ceiling plastering – 100% completed (till 1st – 20th floor), Masonry – Block/ brick – 98% completed (till 19th floor Completed), Internal plaster – 1st floor – 60% completed, 94% completed (till 18th floor completed)

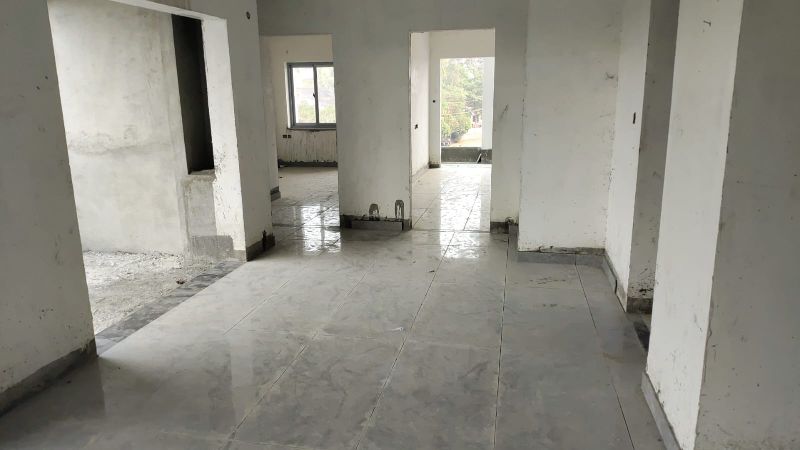

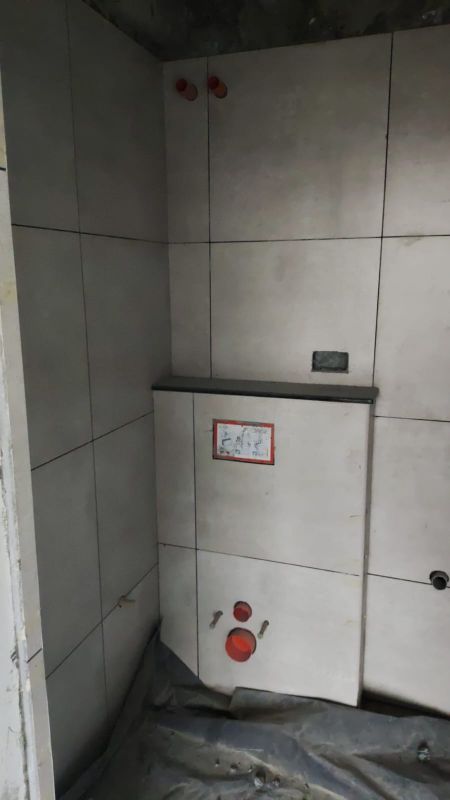

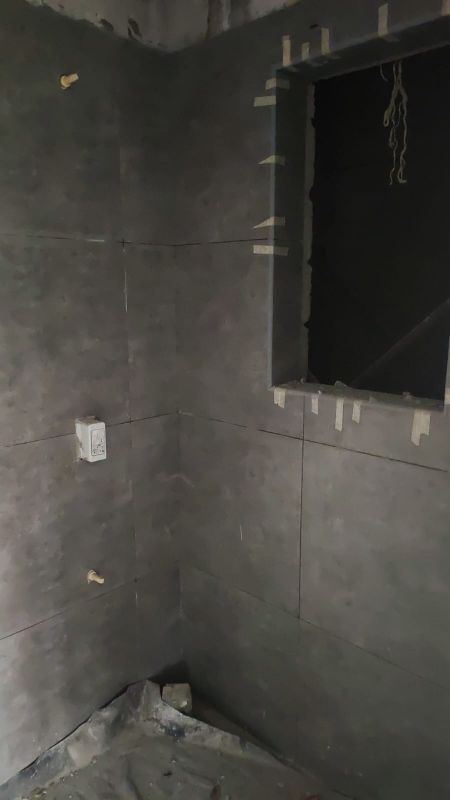

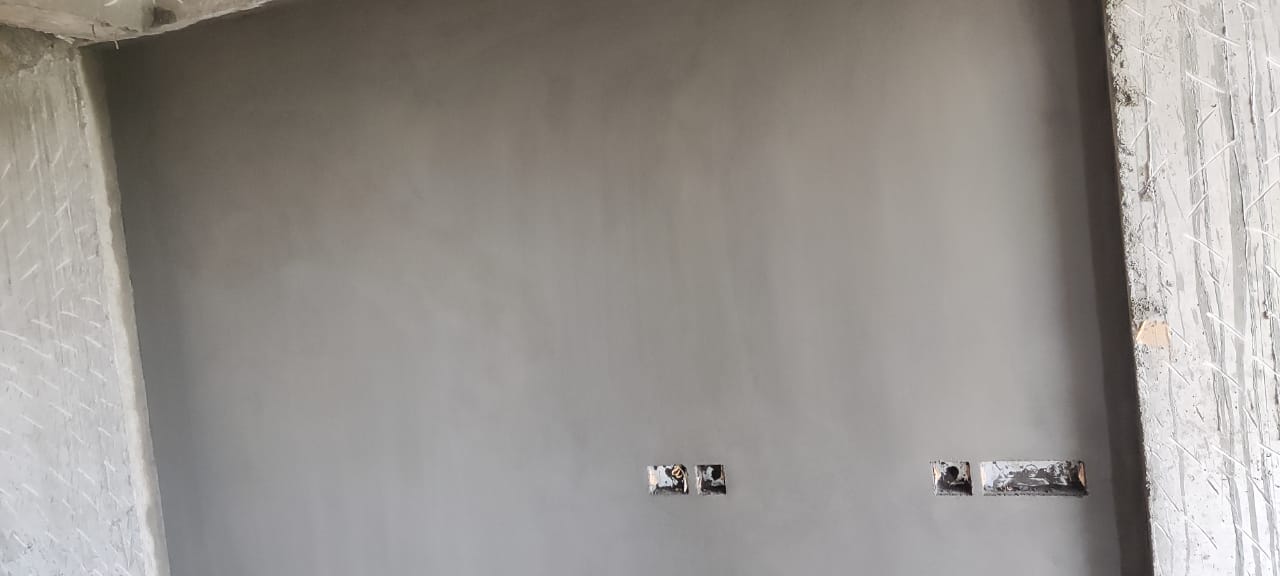

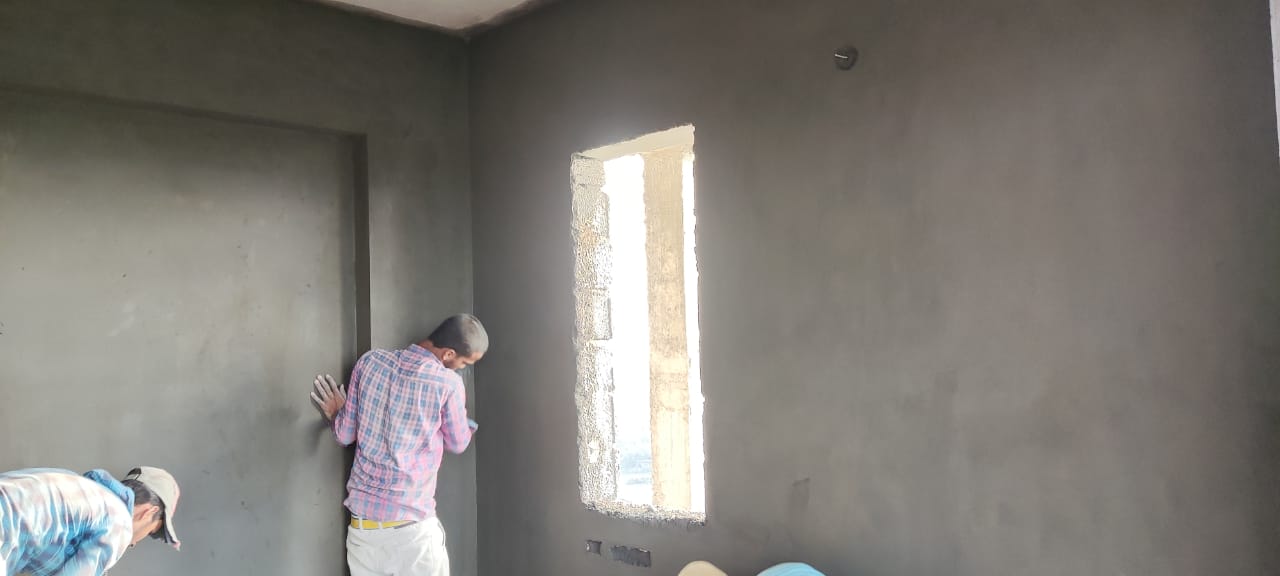

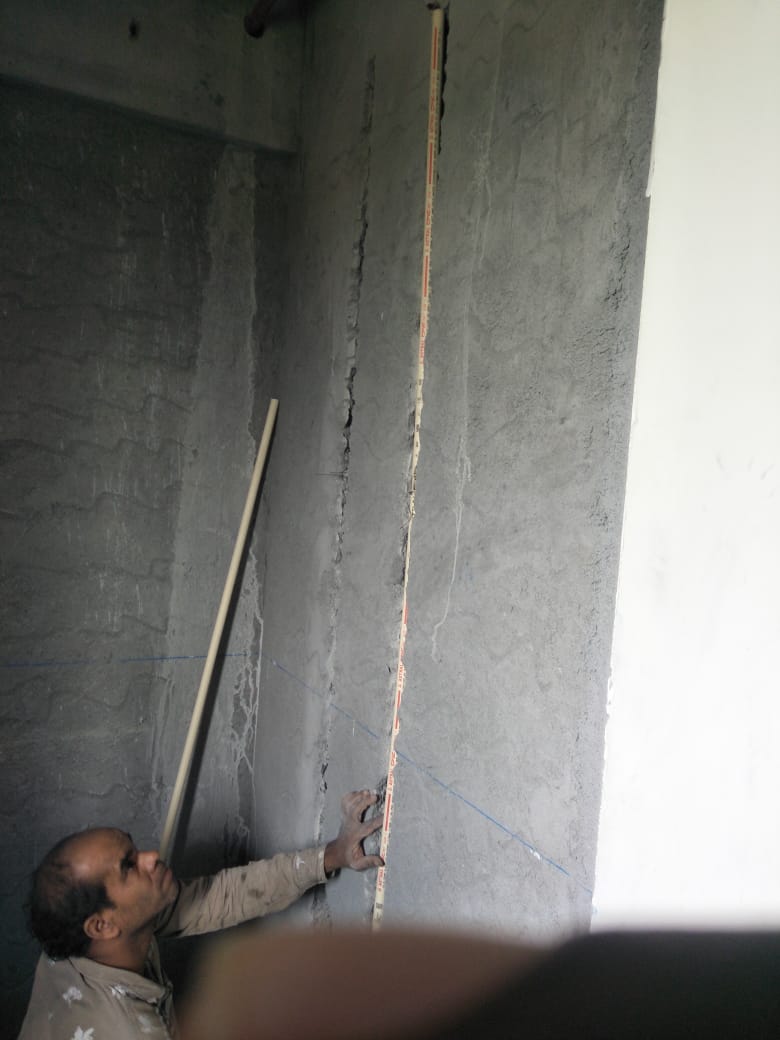

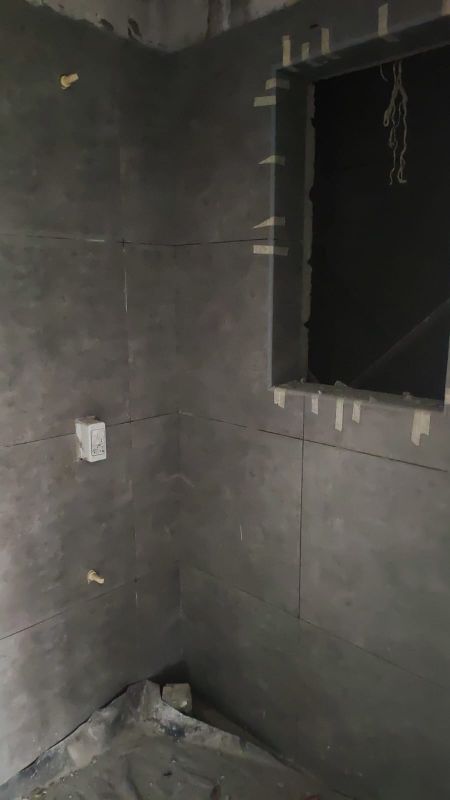

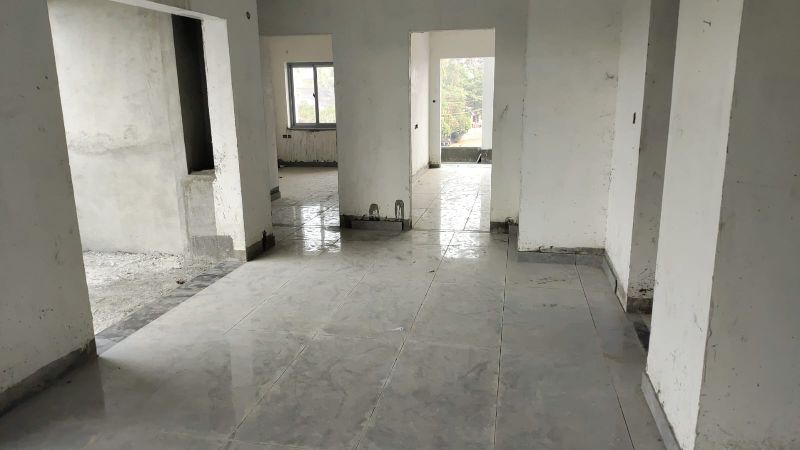

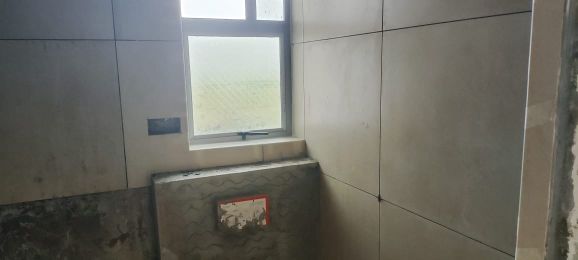

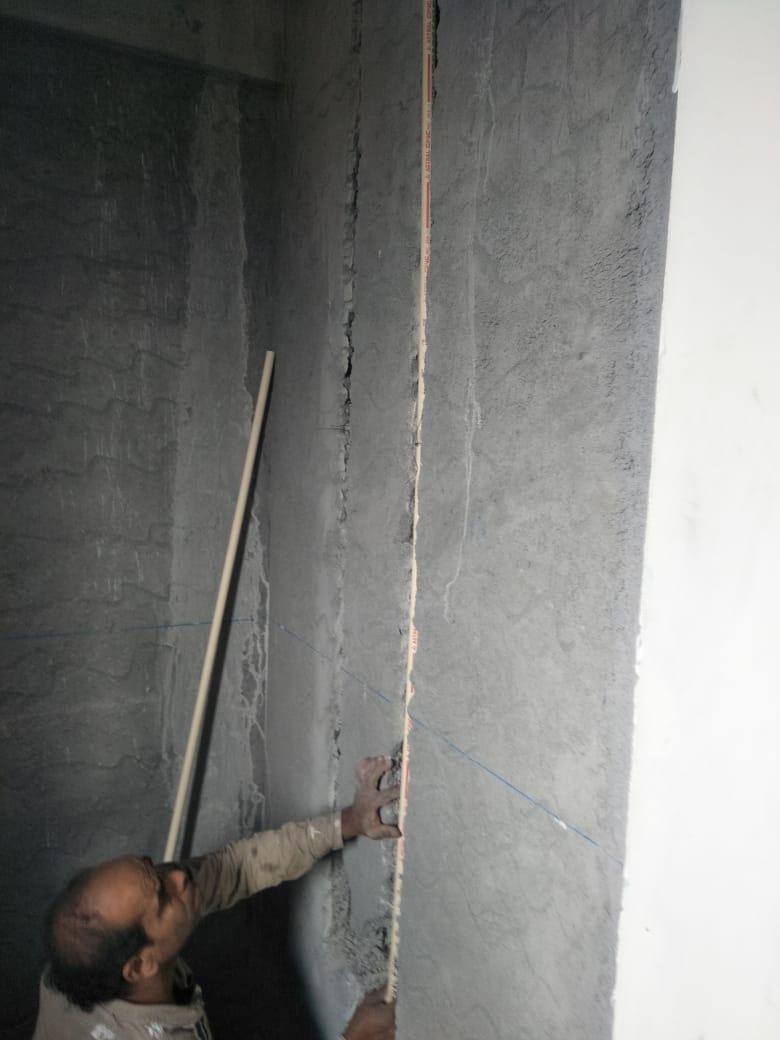

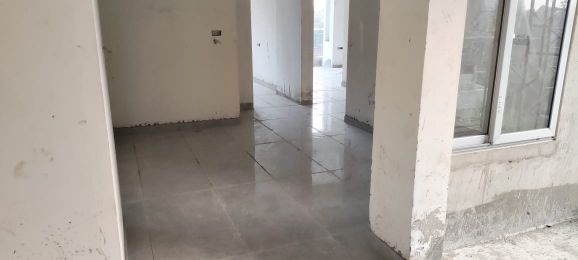

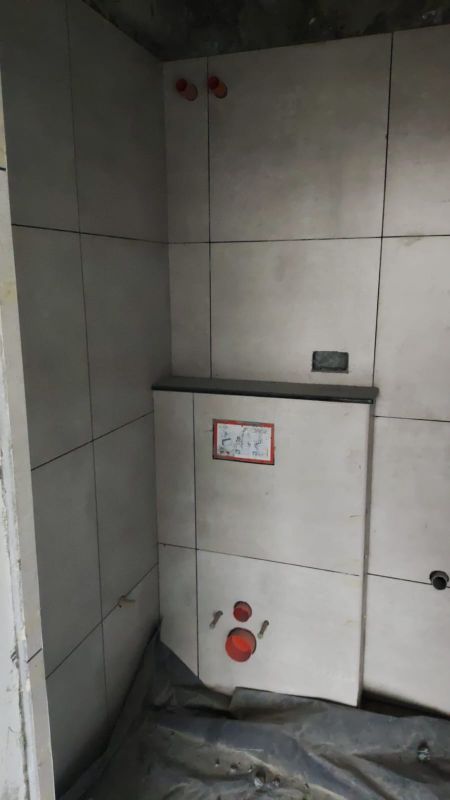

  • Internal Finishes – Main door -sample flat only, Wall tiling – 3rd to 7th floor (toilets) – 14% completed, Flooring – 3rd floor (A,B,C,D,E – 80% completed), 4th,5th,6th,7th,8th floor (15% completed), putty works & Painting – putty 50% completed (till 9th floor 2 coat putty – completed, 10th to 16th floor one coat putty 90% completed, 17th floor – 80% completed, 18th floor – 50% completed ), primer up to 17th floor completed, 18th floor completed, Water proofing – 35% completed (till 12th floor bathrooms only, balcony – upto 8th floor 75% completed), Door frame fixtures – 95% completed (18th floor – 80% completed), Handrails – 20% completed (firestair handrail GF to 14th floor completed, balcony handrail – frameonly – 70% completed))

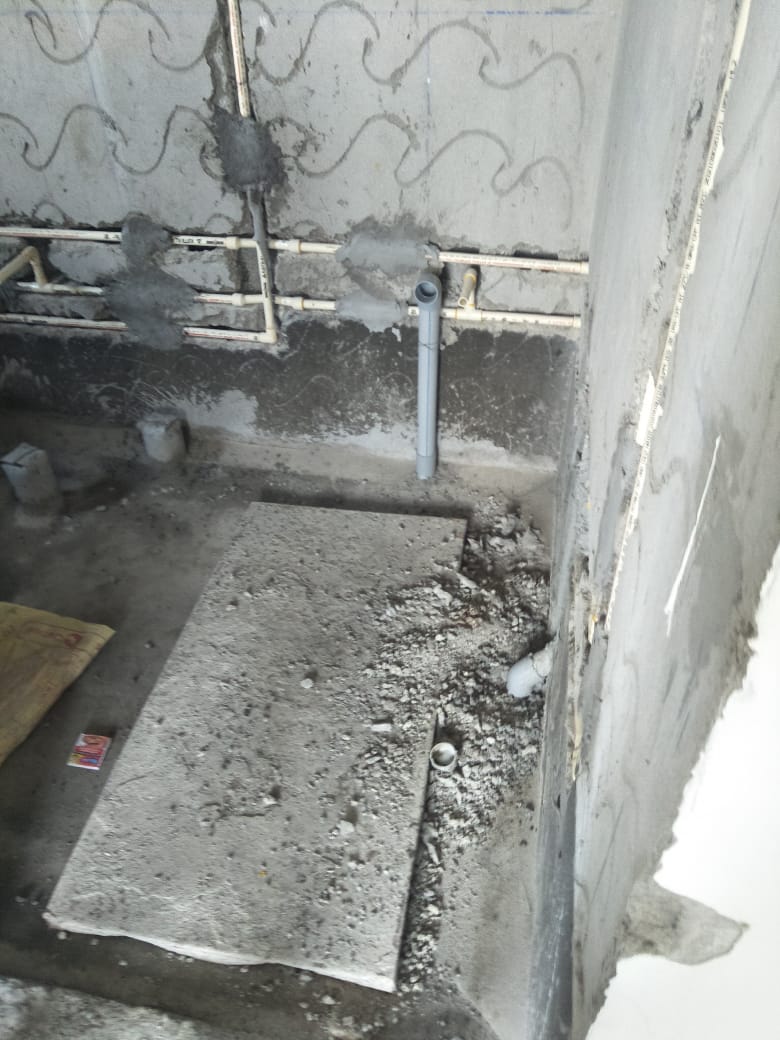

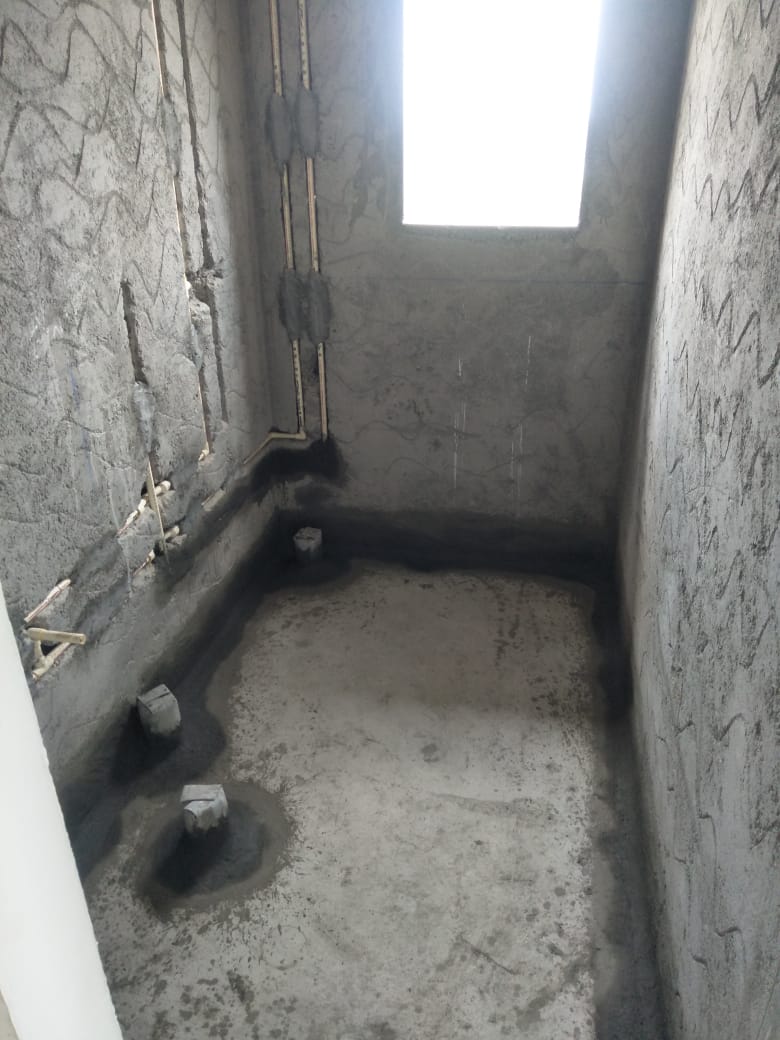

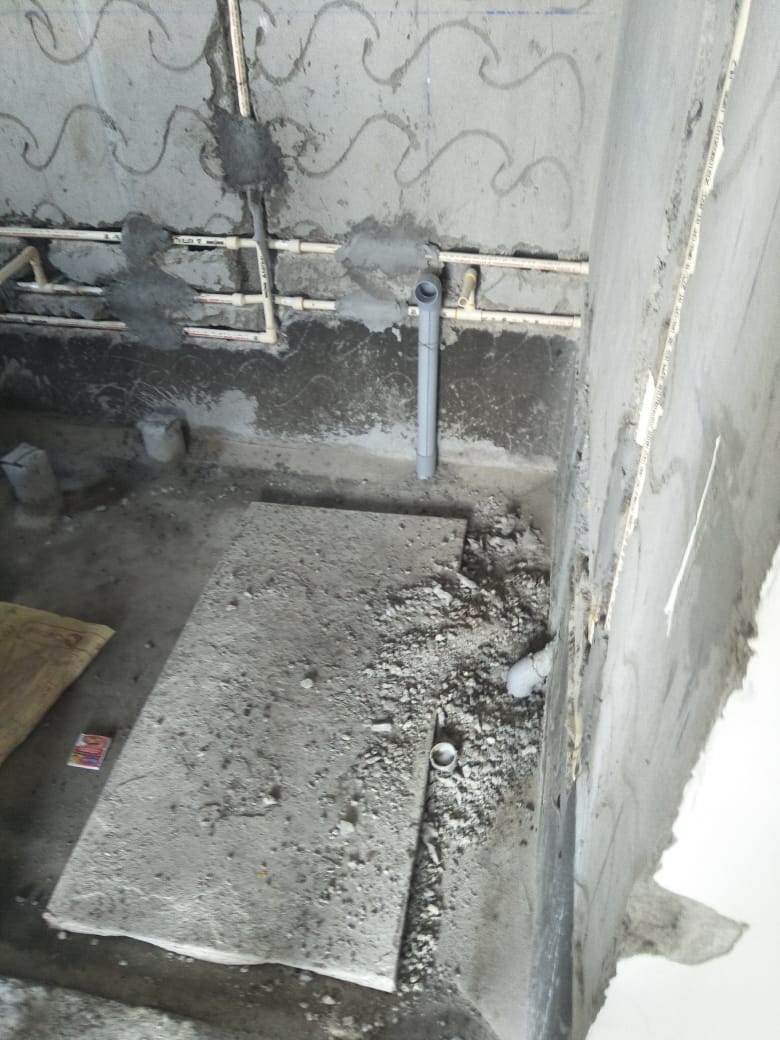

  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 55% completed (till 10th floor), Corecutting – till 16th floor completed, Centralised Gas piping system- mock up only, Firefighting final fixtures – horizontal pipe line till 15th floor completed, fire alarm work started

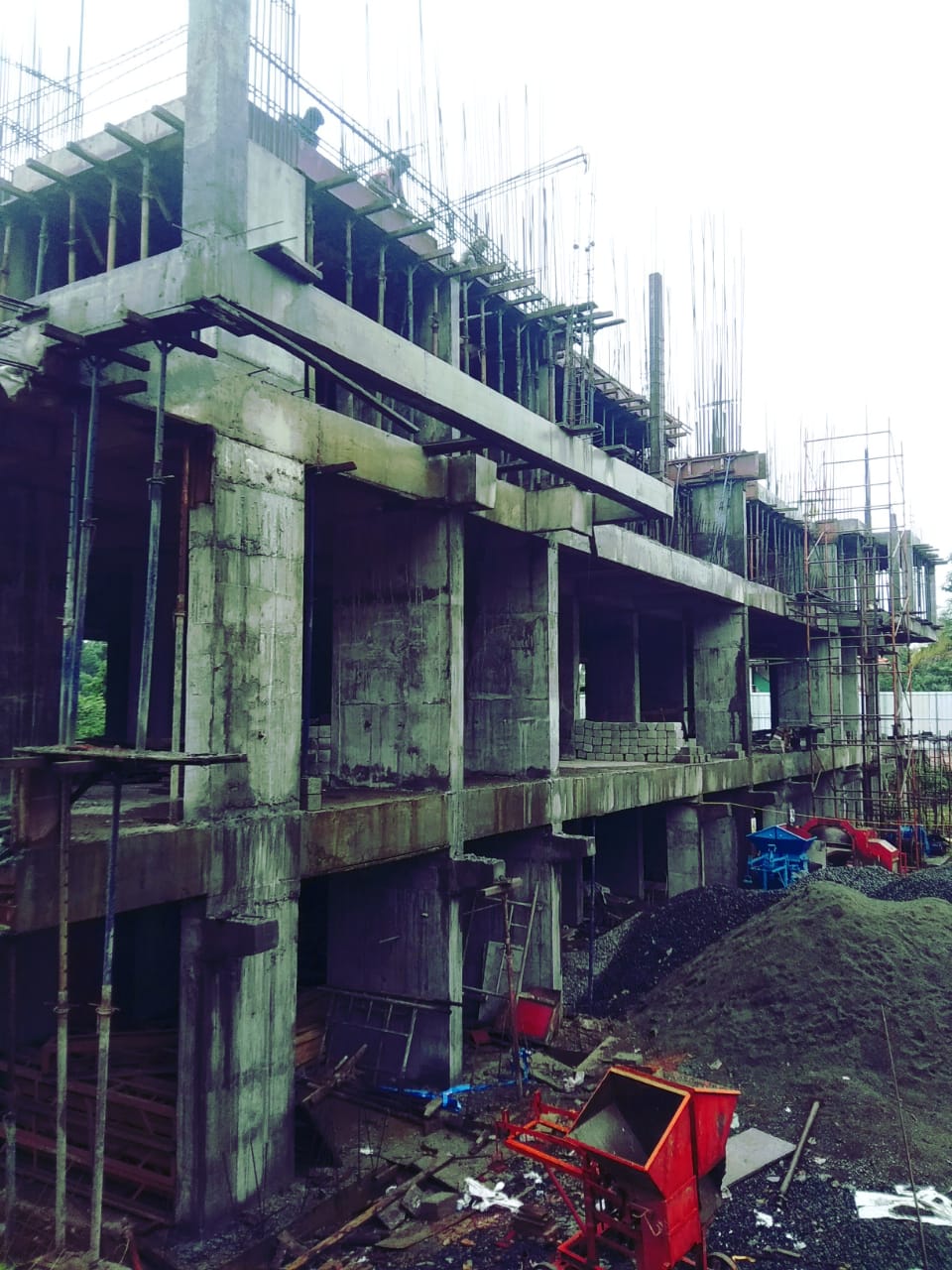

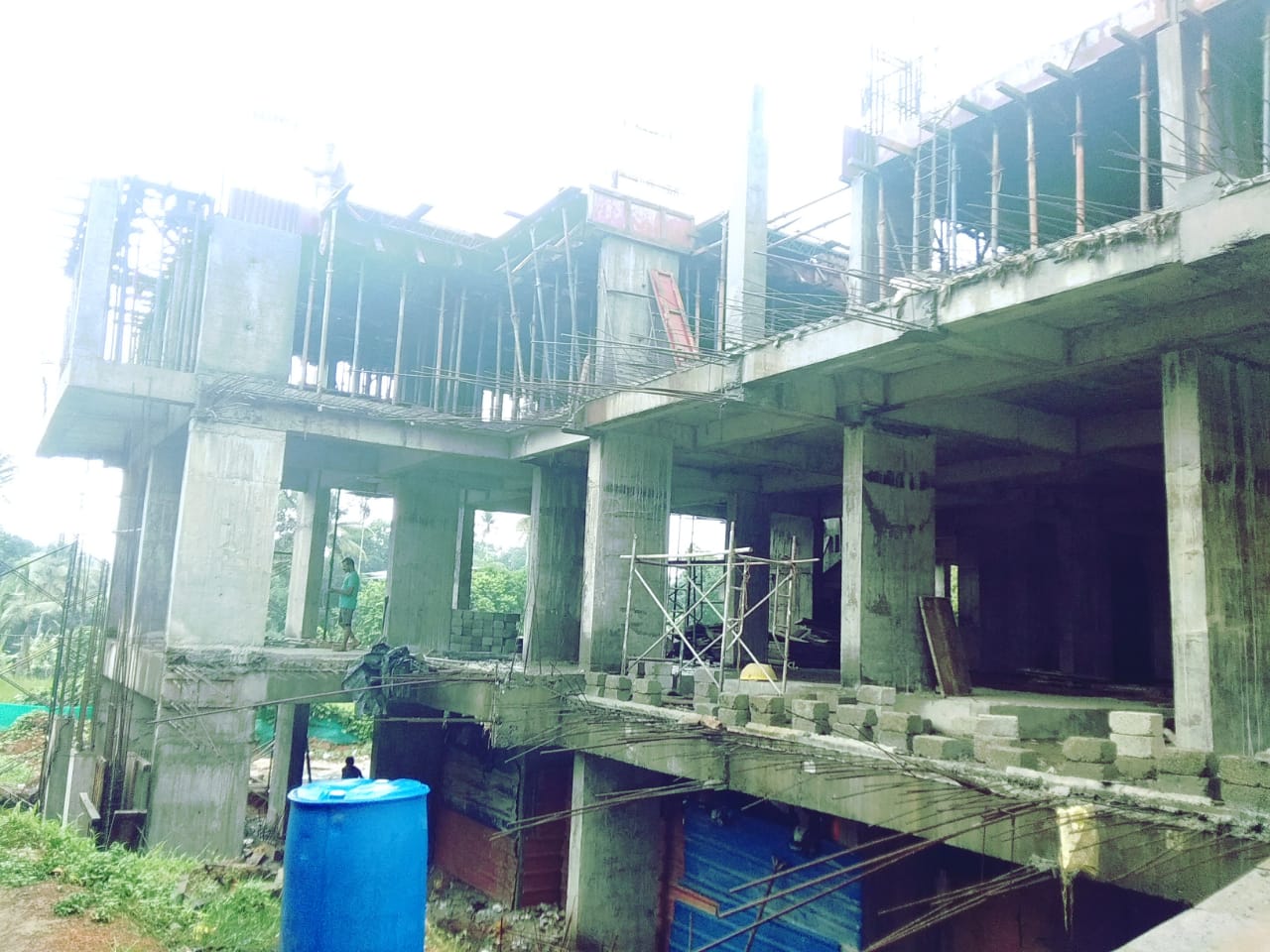

  • External Finishes – Windows & Sliding doors – 3rd floor – 75% completed, External Plastering – 98% completed (B flat outside), A Flat outside – 92% completed, E Flat outside – 97% completed, C Flat outside – 99% completed, D flat outside – 90% completed, External Painting – primer – 60% completed, damp proof – 50% completed)
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer application 100% completed, First coat painting 100% completed, Final coat painting 100% completed

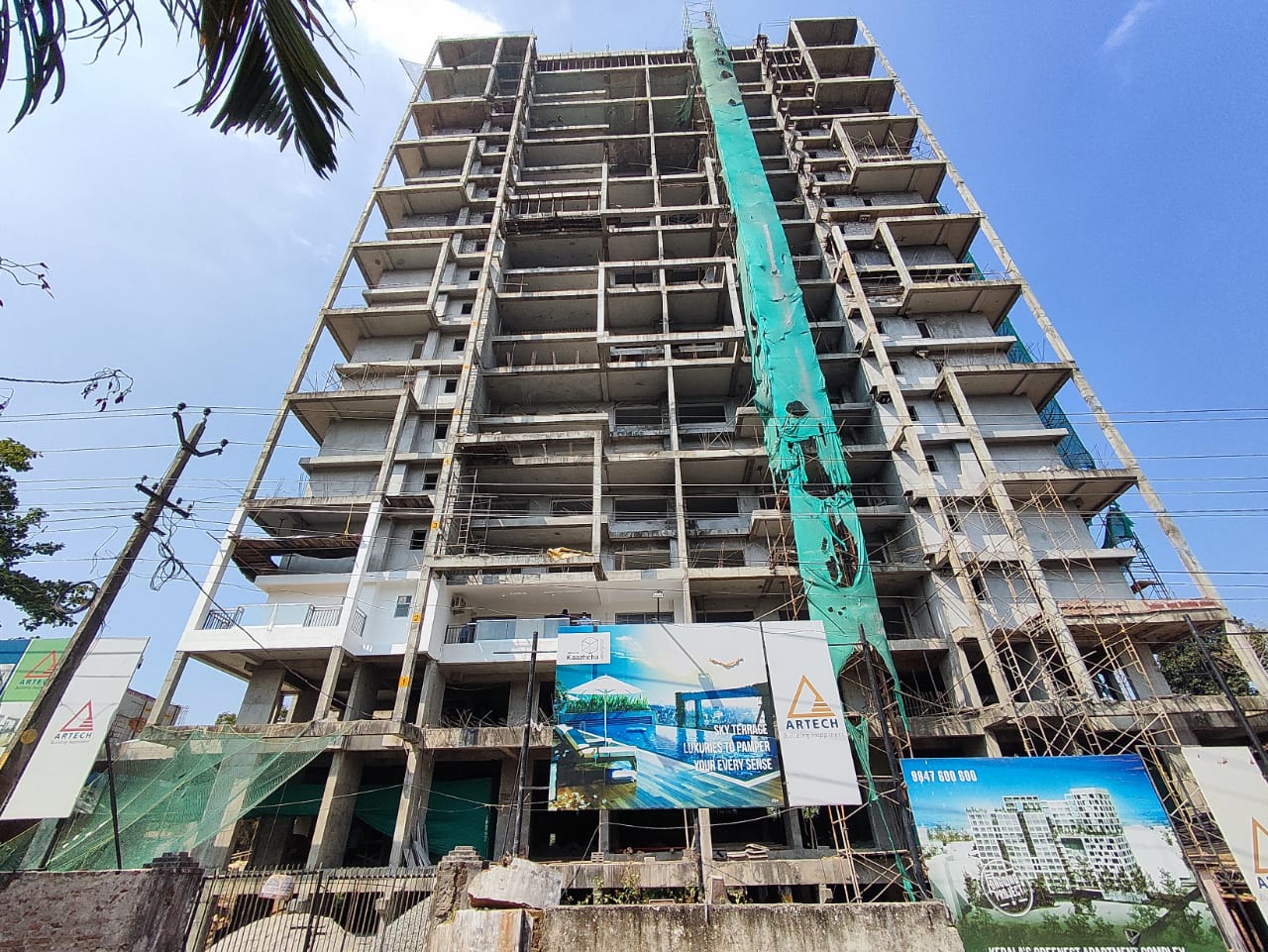

As per the current work status from our site, we are targeted to complete the following works by the end of MARCH 2023.

  • Structural Works – Amenities ; Swimming pool wall – 50% to be completed, childrens play area, SHR, LMR to be completed

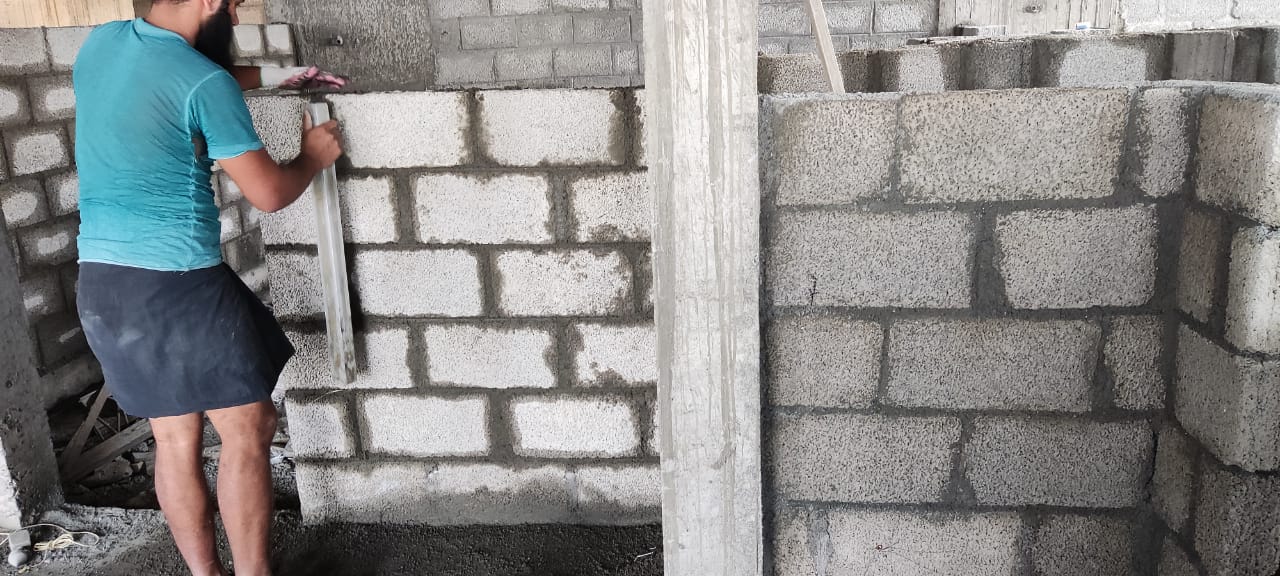

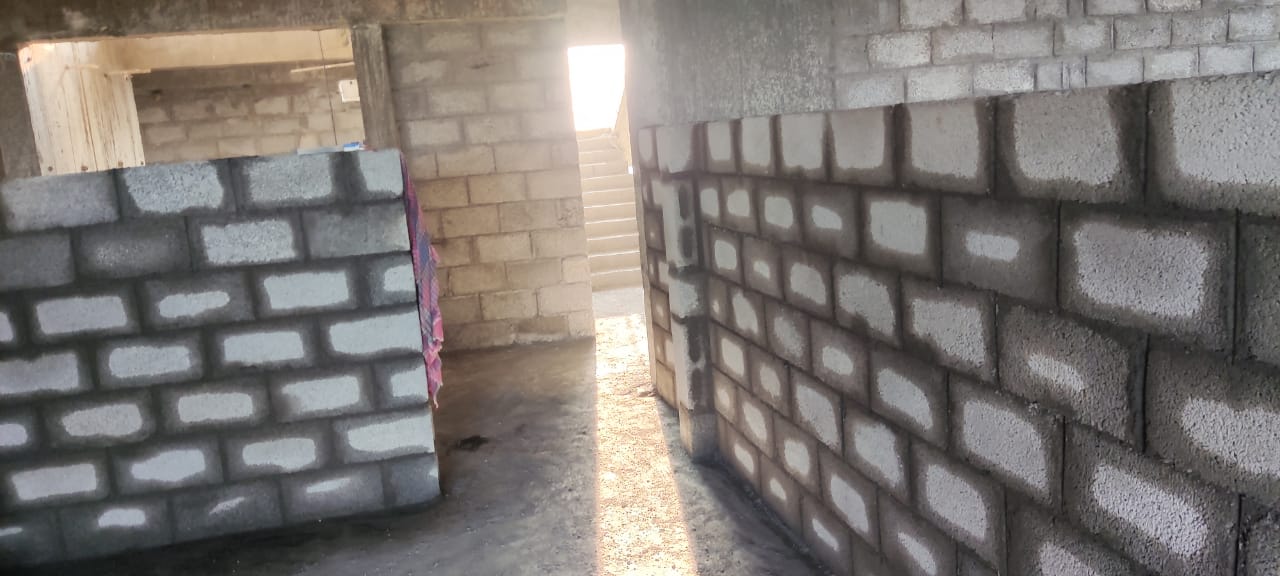

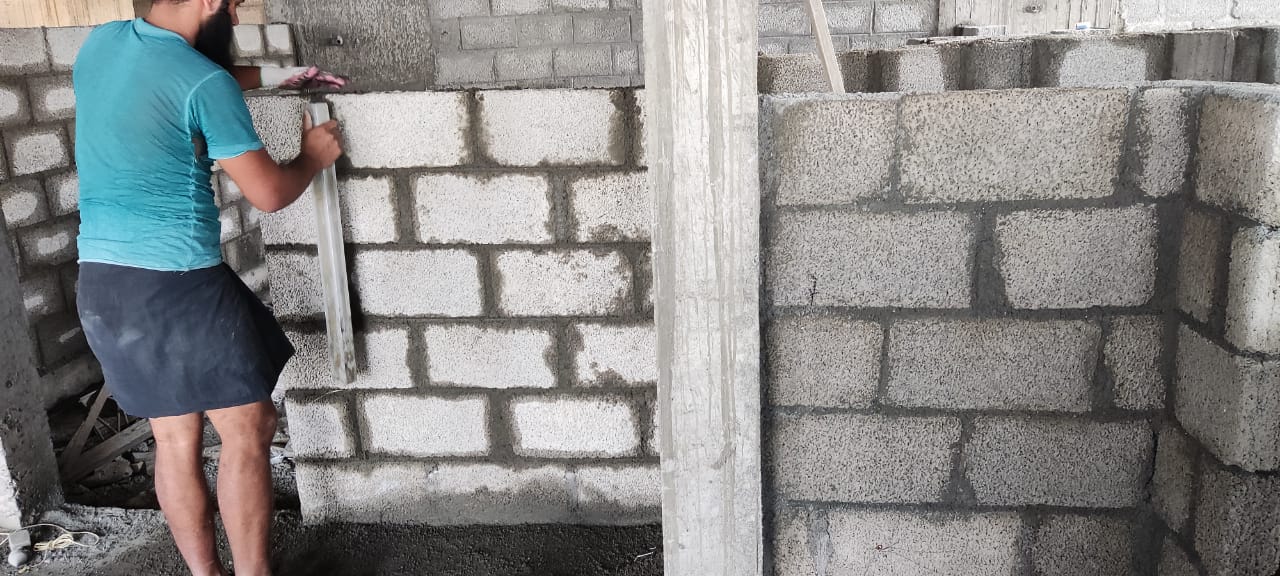

  • Civil Works – Block work – 19th floor 100% to be completed, Inside plastering – 1st floor – 80% to be completed, 19th floor to be completed

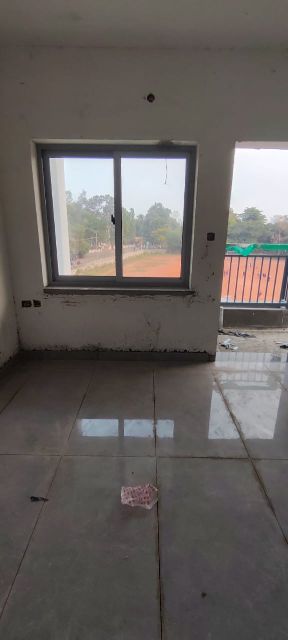

  • Internal Finishes – Wall tiling – 8th, 9th floor 50% to be completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing work – 60% to be completed
  • External Finishes – Windows & Sliding doors – 3rd floor – 80% completed, 4th,5th floor – 50% to be completed

Work status as on 11-01-2023, we have completed the following.

  • Structural Works – Pile cap – 82% completed, slab – 95% completed, swimming pool base slab completed
  • Civil Works – Ceiling plastering – 100% completed (till 1st – 20th floor), Masonry – Block/ brick – 98% completed (till 19th floor Completed), Internal plaster – 94% completed (till 18th floor completed)
  • Internal Finishes – Main door -sample flat only, Wall tiling – 3rd to 6th floor (toilets) – 12% completed, Flooring – 3rd floor (B,C,D,E – 80% completed), 4th,5th,6th,7th floor (15% completed) putty works & Painting – putty 50% completed (till 9th floor 2 coat putty – completed, 10th to 16th floor one coat putty 90% completed, 17th floor – 80% completed, 18th floor – 50% completed ), primer up to 17th floor completed, 18th floor completed, Water proofing – 30% completed (till 10th floor bathrooms only, balcony – upto 8th floor 75% completed), Door frame fixtures – 95% completed (18th floor – 80% completed), Handrails – 20% completed (firestair handrail GF to 14th floor completed, balcony handrail – frameonly – 65% completed))
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 54% completed (till 9th floor), Corecutting – till 16th floor completed, Centralised Gas piping system- mock up only, Firefighting final fixtures – horizontal pipe line till 15th floor completed, fire alarm work started
  • External Finishes – Windows & Sliding doors – 3rd floor – 50% completed, External Plastering – 96% completed (B flat outside), A Flat outside – 91% completed, E Flat outside – 97% completed, C Flat outside – 99% completed, External Painting – primer – 60% completed, damp proof – 50% completed)
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer application 100% completed, First coat painting 100% completed, Final coat painting 100% completed

As per the current work status from our site, we are targeted to complete the following works by the end of FEBRUARY 2023.

  • Structural Works – Amenities ; Swimming pool wall, childrens play area, SHR, LMR, ramp, retaining wall to be completed
  • Civil Works – Block work – 19th floor 100% to be completed, Inside plastering – 1st floor, 19th floor to be completed
  • Internal Finishes – Water proofing – 35% to be completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing work – 60% to be completed
  • External Finishes – Windows & Sliding doors – 3rd floor – 70% completed

Work status as on 14-01-2023, we have completed the following.

  • Structural Works – Pile cap – 82% completed, slab – 95% completed, swimming pool base slab completed
  • Civil Works – Ceiling plastering – 100% completed (till 1st – 20th floor), Masonry – Block/ brick – 98% completed (till 19th floor Completed), Internal plaster – 93% completed (till 18th floor completed)
  • Internal Finishes – Main door -sample flat only, Wall tiling – 3rd to 6th floor (toilets) – 12% completed, Flooring – 3rd floor (B,C,D,E – 70% completed), putty works & Painting – putty 50% completed (till 9th floor 2 coat putty – completed, 10th to 16th floor one coat putty 90% completed, 17th floor – 80% completed, 18th floor – 50% completed ), primer up to 17th floor completed, 18th floor completed, Water proofing – 25% completed (till 8th floor bathrooms only, balcony – upto 7th floor 75% completed), Door frame fixtures – 95% completed (18th floor – 80% completed), Handrails – 15% completed (firestair handrail GF to 14th floor completed, balcony handrail – frameonly – 40% completed))
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 52% completed (till 8th floor), Corecutting – till 15th floor completed, Centralised Gas piping system- mock up only, Firefighting final fixtures – horizontal pipe line till 15th floor completed
  • External Finishes – Windows & Sliding doors – sample flat only, External Plastering – 95% completed (B flat outside), A Flat outside – 90% completed, E Flat outside – 95% completed, C Flat outside – 98% completed, External Painting – primer – 60% completed, damp proof – 50% completed)
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer application 100% completed, First coat painting 100% completed, Final coat painting 100% completed

As per the current work status from our site, we are targeted to complete the following works by the end of JANUARY 2023.

  • Structural Works – Amenities ; Swimming pool wall, childrens play area, SHR, LMR, ramp, retaining wall to be completed
  • Civil Works – Block work – 19th floor 100% to be completed, inside plastering – 19th floor to be completed
  • Internal Finishes – Wall tiling – 3rd to 6th floor toilets 50% to be completed, Door frame fixing -18 th,19th floor 100% to be completed, putty and painting – 55% to be completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing work – 60% to be completed
  • External Finishes – External Plastering – 90% to be completed

As per the current work status from our site, we are targeted to complete the following works by the end of DECEMBER 2022.

  • Structural Works – Amenities ; Swimming pool, childrens play area, SHR, LMR, ramp, retaining wall to be completed
  • Civil Works – Block work – 19th floor 100% to be completed
  • Internal Finishes – Wall tiling – 3rd to 6th floor toilets 50% to be completed, Door frame fixing -18 th,19th floor 100% to be completed, putty and painting – 55% to be completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing work – 11th,12th,13th floor -100% to be completed, Firefighting works – 30% to be completed
  • External Finishes – External Plastering – 80% to be completed

Work status as on 13-12-2022, we have completed the following.

  • Structural Works – Pile cap – 82% completed, slab – 95% completed
  • Civil Works – Ceiling plastering – 100% completed (till 1st – 20th floor), Masonry – Block/ brick – 97% completed (till 19th floor Completed), Internal plaster – 92% completed (till 18th floor completed)
  • Internal Finishes – Main door -sample flat only, Wall tiling – 3rd to 6th floor (toilets) – 12% completed, Flooring – (sample flat only), putty works & Painting – putty 50% completed (till 9th floor 2 coat putty – completed, 10th to 16th floor one coat putty 83% completed, 18th floor – 35% completed ), primer up to 17th floor completed, 18th floor – 50% completed, Water proofing – 25% completed (till 8th floor bathrooms only, balcony – upto 7th floor 75% completed), Door frame fixtures – 95% completed (18th floor – 80% completed), Handrails – 15% completed (firestair handrail GF to 14th floor completed, balcony handrail – frameonly – 2nd to 8th floor 80% completed))
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 49% completed (till 8th floor), Corecutting – till 15th floor completed, Centralised Gas piping system- mock up only, Firefighting final fixtures – horizontal pipe line till 15th floor completed
  • External Finishes – Windows & Sliding doors – sample flat only, External Plastering – 93% completed (B flat outside), A Flat outside – 90% completed, E Flat outside – 90% completed, C Flat outside – 80% completed, External Painting – mock up only)
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer application 100% completed, First coat painting 100% completed, Final coat painting 100% completed

As per the current work status from our site, we are targeted to complete the following works by the end of NOVEMBER 2022.

  • Structural Works – Amenities ; Swimming pool, childrens play area, SHR, LMR, ramp, retaining wall to be completed
  • Civil Works – Block work – 19th floor 100% to be completed
  • Internal Finishes – Wall tiling – 3rd to 6th floor toilets 50% to be completed, Door frame fixing -18 th,19th floor 100% to be completed, putty and painting – 50% to be completed
  • Electrical, Plumbing & Firefighting works- Concealed plumbing work – 11th,12th,13th floor -100% to be completed, Firefighting works – 30% to be completed
  • External Finishes – External Plastering – 52% to be completed

Work status as on 15-11-2022, we have completed the following.

  • Structural Works – Pile cap – 81% completed, slab – 95% completed, ramp pouring completed, STP work completed
  • Civil Works – Ceiling plastering – 100% completed (till 1st – 20th floor), Masonry – Block/ brick – 97% completed (till 19th floor Completed), Internal plaster – 92% completed (till 18th floor completed)
  • Internal Finishes – Main door -sample flat only, Wall tiling – 3rd to 6th floor (toilets) – 12% completed, Flooring – (sample flat only), putty works & Painting – putty 48% completed (till 9th floor 2 coat putty – completed, 10th to 16th floor one coat putty 83% completed ), primer up to 16th floor completed, Water proofing – 25% completed (till 8th floor bathrooms only, balcony – upto 5th floor 75% completed), Door frame fixtures – 95% completed (18th floor – 80% completed), Handrails – 13% completed (firestair handrail GF to 14th floor completed, balcony handrail – frameonly – 2nd to 6th floor 90% completed))
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 48% completed (till 8th floor), Corecutting – till 15th floor completed, Centralised Gas piping system- mock up only, Firefighting final fixtures – horizontal pipe line till 15th floor completed
  • External Finishes – Windows & Sliding doors – sample flat only, External Plastering – 93% completed (B flat outside), A Flat outside – 40% completed, External Painting – mock up only)
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer application 100% completed, First coat painting 100% completed, Final coat painting 100% completed

Work status as on 11-10-2022, we have completed the following.

  • Structural Works – Pile cap – 80% completed, slab – 95% completed, ramp pouring completed, STP work completed
  • Civil Works – Ceiling plastering – 100% completed (till 20th floor), Masonry – Block/ brick – 92% completed (till 18th floor Completed), Internal plaster – 92% completed (till 18th floor – 90% completed)
  • Internal Finishes – Main door -sample flat only, Wall tiling – 3rd to 6th floor (toilets) – 12% completed, Flooring – (sample flat only), putty works & Painting – putty 48% completed (till 9th floor 2 coat putty – completed, 10th to 16th floor one coat putty 83% completed ), primer up to 16th floor completed, Water proofing – 25% completed (till 8th floor bathrooms only, balcony – 2nd, 3rd floor 50% completed), Door frame fixtures – 95% completed (18th floor – 80% completed), Handrails – 13% completed (firestair handrail GF to 14th floor completed)
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 48% completed (till 8th floor), Corecutting – till 15th floor completed, Centralised Gas piping system- mock up only, Firefighting final fixtures – horizontal pipe line till 15th floor completed
  • External Finishes – Windows & Sliding doors – sample flat only, External Plastering – 90% completed (B flat outside), A Flat outside – 10% completed (overall 25% completed), External Painting – mock up only)
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer application 100% completed, First coat painting 100% completed, Final coat painting 100% completed

As per the current work status from our site, we are targeted to complete the following works by the end of OCTOBER 2022.

  • Structural Works – AAmenities ; Swimming pool, childrens play area, SHR, LMR, ramp, retaining wall to be completed
  • Civil Works – Block work – 19th floor 50% to be completed
  • Internal Finishes – Wall tiling – 3rd to 6th floor toilets 50% to be completed, Door frame fixing -18 th floor 100% to be completed, putty and painting – 50% to be completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing work – 11th,12th,13th floor -100% to be completed, Firefighting works – 30% to be completed
  • External Finishes – External Plastering – 52% to be completed

Work status as on 17-09-2022, we have completed the following.

  • Structural Works – Pile cap – 80% completed, slab – 95% completed, ramp pouring completed, STP work on progress
  • Civil Works – Ceiling plastering – 100% completed (till 20th floor), Masonry – Block/ brick – 90% completed (till 17th floor Completed, 18 floor – 90% completed), Internal plaster – 90% completed (till 17th floor completed, 18th floor – 20% completed)
  • Internal Finishes – Main door -sample flat only, Wall tiling – 3rd to 6th floor – 10% completed, Flooring – (sample flat only), putty works & Painting – putty 48% completed (till 9th floor 2 coat putty – completed, 10th to 16th floor one coat putty 83% completed ), primer up to 16th floor completed, Water proofing – 25% completed (till 8th floor bathrooms only, balcony – 2nd, 3rd floor 50% completed), Door frame fixtures – 90% completed (up to 17th floor completed), Handrails – 13% completed (firestair handrail GF to 14th floor completed)
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 48% completed (till 8th floor), Corecutting – till 15th floor completed, Centralised Gas piping system- mock up only, Firefighting final fixtures – horizontal pipe line till 15th floor completed 24% completed
  • External Finishes – Windows & Sliding doors – sample flat only , External Plastering – 25% completed (B flat outside), External Painting – mock up only)
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer application 100% completed, First coat painting 100% completed, Final coat painting 100% completed.

As per the current work status from our site, we are targeted to complete the following works by the end of SEPTEMBER 2022.

  • Structural Works – Amenities ; Swimming pool, childrens play area, SHR, LMR, ramp, retaining wall to be completed

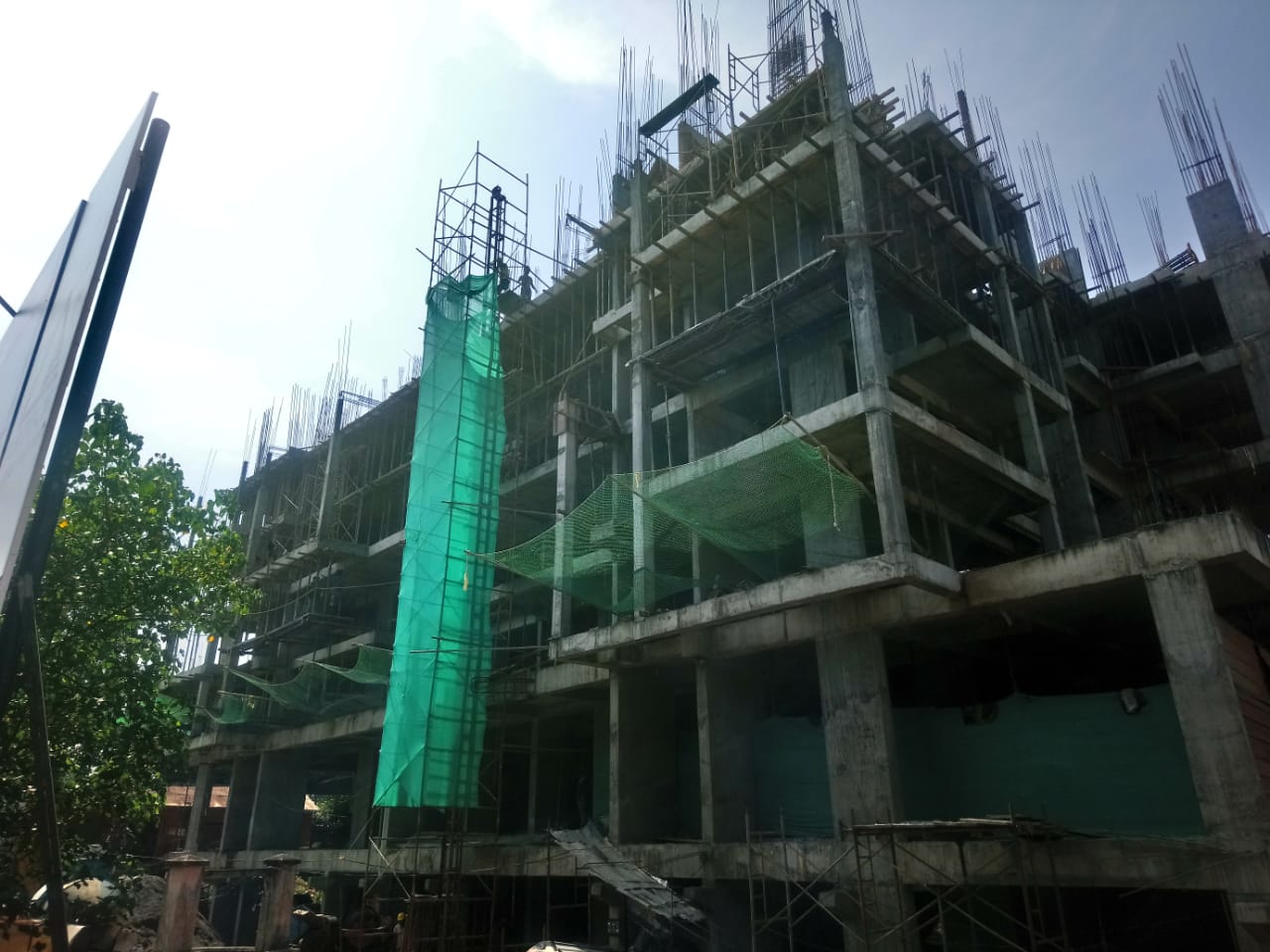

  • Civil Works – Block work – 18th,19th floor 100% to be completed, Internal plaster – 18th floor 100% to be completed.
  • Internal Finishes – Wall tiling – 3rd to 6th floor toilets 50% to be completed, Door frame fixing -18 th floor 100% to be completed, putty and painting – 50% to be completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing work – 11th,12th,13th floor -100% to be completed, Corecutting upto 17th floor – 100% to be completed , Firefighting works – 30% to be completed
  • External Finishes – External Plastering – 52% to be completed

Work status as on 09-07-2022, we have completed the following.

  • Structural Works – Pile cap – 80% completed, slab – 95% completed
  • Civil Works – Ceiling plastering – 100% completed (till 20th floor), Masonry – Block/ brick – 89% completed (till 16th floor 95% Completed, 17th floor – 40% completed) , Internal plaster – 87% completed (till 15th floor completed, 16th floor – 75% completed)
  • Internal Finishes – Main door -sample flat only, Wall tiling – sample flat only, Flooring – (sample flat only), putty works & Painting – putty 42% completed (till 9th floor 2 coat putty – completed, 10th to 14th floor one coat putty 80% completed ), primer up to 15th floor completed, Water proofing – 25% completed (till 8th floor bathrooms only, balcony – 2nd, 3rd floor 50% completed), Door frame fixtures – 80% completed (up to 16th floor completed), Handrails -10% completed (GF to sample flat completed)
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 45% completed (till 6th floor), Corecutting – till 12th floor completed, Centralised Gas piping system- mock up only, Firefighting final fixtures – 22% completed (till 6th floor)
  • External Finishes – Windows & Sliding doors – sample flat only , External Plastering – 22% completed (B flat outside), External Painting – mock up only)
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer application 100% completed, First coat painting 100% completed, Final coat painting 100% completed

As per the current work status from our site, we are targeted to complete the following works by the end of JULY 2022.

  • Structural Works – Amenities ; Swimming pool, childrens play area, OHT,SHR,LMR, ramp, retaining wall to be completed
  • Civil Works – Block work – 17th floor 100% to be completed, Internal plaster – 17th floor 100% to be completed.
  • Internal Finishes – Water proofing – (balcony 2nd, 3rd, 4th floor )- 100% to be completed, Door frame fixing 95% to be completed ( up to 17 th floor 100% to be completed)
  • Electrical, Plumbing & Firefighting works – Concealed plumbing work – 7th,8th,9th,10th floor -100% to be completed, Corecutting upto 14th floor -100% to be completed , Firefighting works 7th, 8th, 9th floor -100% to be completed
  • External Finishes – Windows & Sliding doors – 50% to be completed, External Plastering – 50% to be completed

Work status as on 11-06-2022, we have completed the following.

  • Structural Works – Pile cap – 80% completed, slab – 95% completed
  • Civil Works – Ceiling plastering – 100% completed (till 20th floor), Masonry – Block/ brick -87% completed (till 16th floor) , Internal plaster – 84% completed (till 14th floor completed, 15 th floor – 70% completed, 16th floor – 25% completed)
  • Internal Finishes – Main door – sample flat only, Wall tiling – sample flat only , Flooring – (sample flat only), putty works & Painting – putty 40% completed(till 9th floor completed), primer up to 14th floor completed, Water proofing – 20% completed (till bathrooms 7th floor, balcony – 2nd , 3rd floor 50% completed), Door frame fixtures -80% completed (up to 16th floor completed), Handrails -10% completed (GF to sample flat completed)
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works- 45% completed (till 6th floor), Corecutting – till 12th floor completed, Centralised Gas piping system- mock up only, Firefighting final fixtures – 20% completed (till 6th floor)
  • External Finishes – Windows & Sliding doors , External Plastering – 20% completed (front side) , External Painting – mock up only)
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer application 100% completed , First coat painting 100% completed ,Final coat painting 100% completed

As per the current work status from our site, we are targeted to complete the following works by the end of JUNE 2022.

  • Structural Works – Amenities : Swimming pool, childrens play area, OHT,SHR,LMR, ramp, retaining wall to be completed
  • Civil Works – Block work – (17th – 20th floor) 100% to be completed, Internal plaster -15th, 16th floor 100% to be completed.
  • Internal Finishes – Water proofing – (balcony 2nd, 3rd, 4th floor )- 100% to be completed, Door frame fixing 90% to be completed ( up to 17 th floor 100% to be completed)
  • Electrical, Plumbing & Firefighting works – Concealed plumbing work – 7th,8th,9th 10th floor -100% to be completed ,Corecutting upto 14th floor -100% to be completed , Firefighting works 7th, 8th, 9th floor -100% to be completed
  • External Finishes – Windows & Sliding doors – 50% to be completed, External Plastering – 50% to be completed

Work status as on 13-04-2022, we have completed the following.

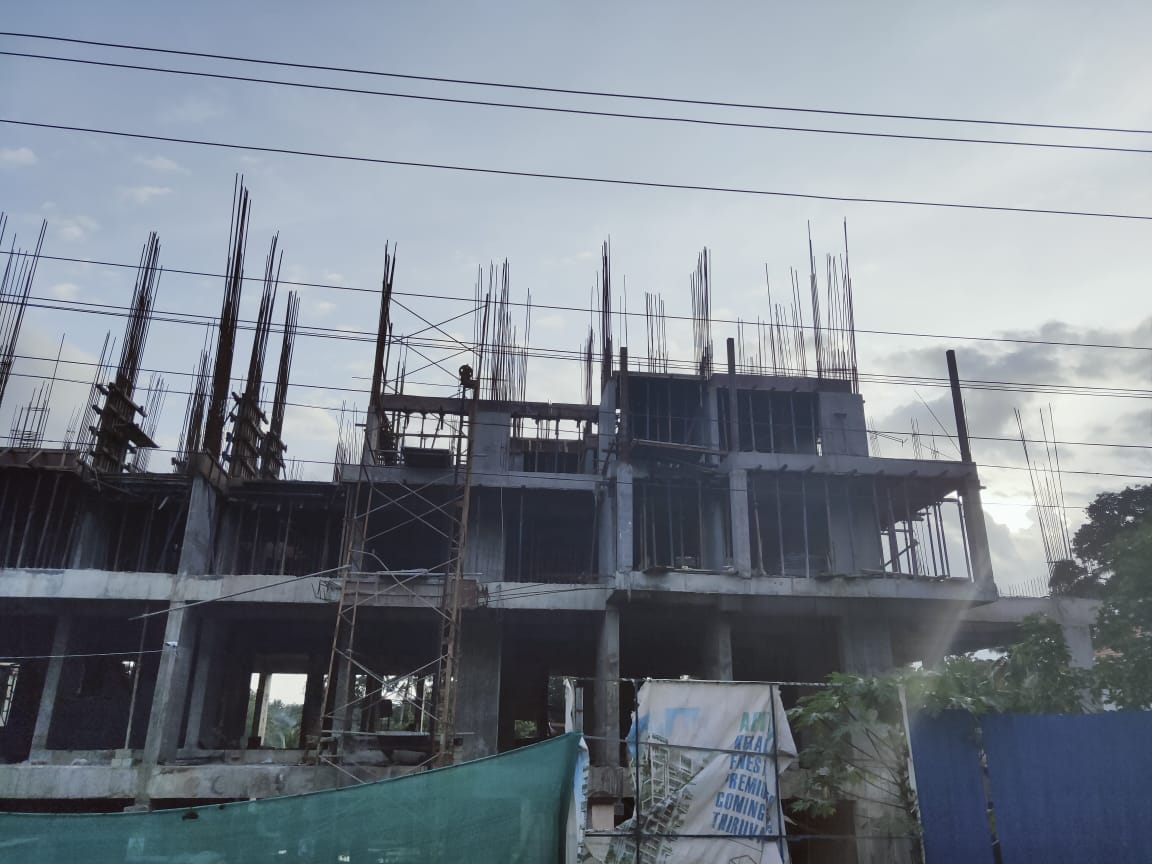

  • Structural Works – Pile cap – 80% completed, slab – 95% completed
  • Civil Works – Ceiling plastering – 100% completed (till 20th floor), Masonry – Block/ brick -83% completed (till 16th floor) , Internal plaster -75% completed (till 14th floor)

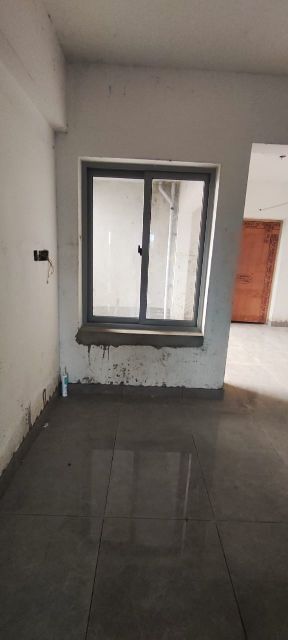

  • Internal Finishes – Main door – 2% completed (sample flat only),Wall tiling – 2% completed (sample flat only) , Flooring – 3% completed (sample flat only), putty works & Painting – putty 40% completed(till 9th floor completed), primer (8th,9th,10th,11th floor completed), Door frame fixtures -80% completed (up to 16th floor completed), Handrails -10% completed (GF to sample flat completed), Water proofing – 20% completed (till bathrooms 6th floor)
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works- 35% completed (till 5th floor), Corecutting – till 9th floor completed, Centralised Gas piping system- 5% completed (mock up only), Firefighting final fixtures – 20% completed (till 6th floor)
  • External Finishes – Windows & Sliding doors – 5% completed (mockup only), External Plastering – 20% completed (front side) , External Painting – 2% completed (mock up only)
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer application 100% completed , First coat painting 100% completed ,Final coat painting 100% completed

As per the current work status from our site, we are targeted to complete the following works by the end of APRIL 2022.

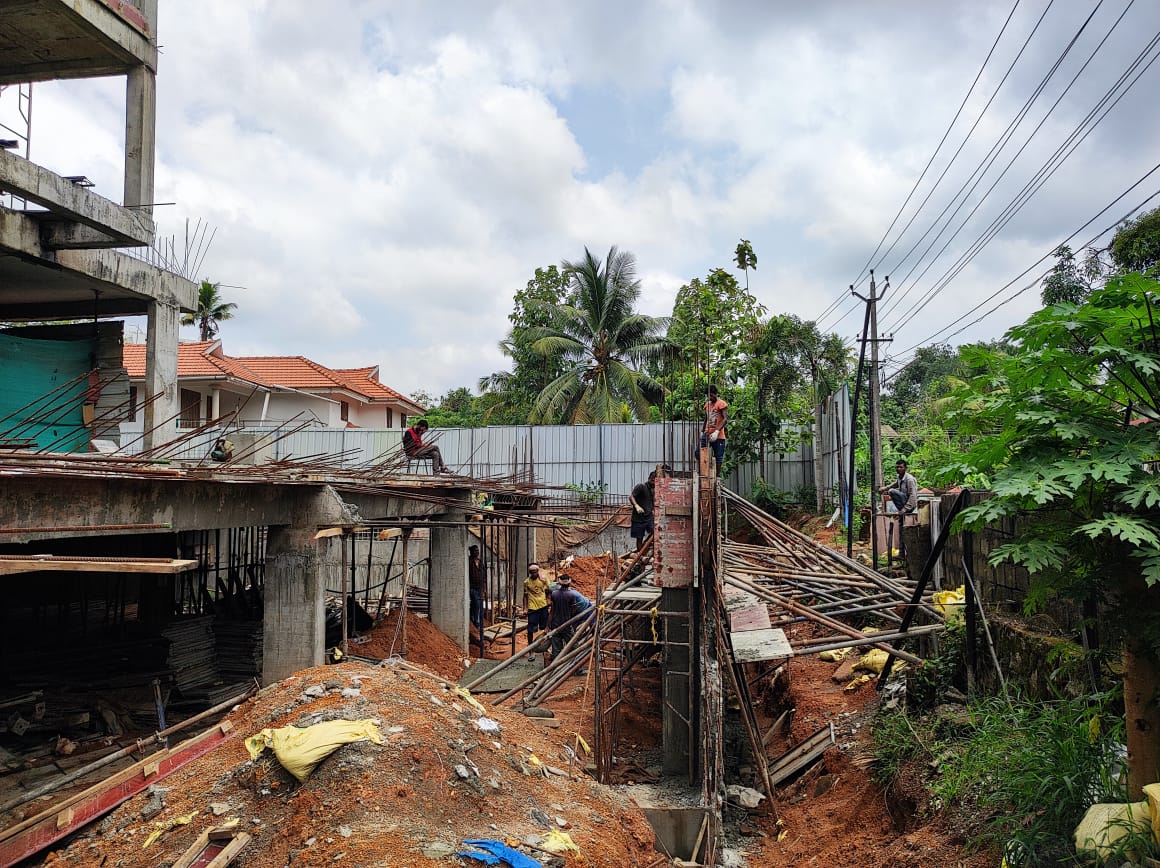

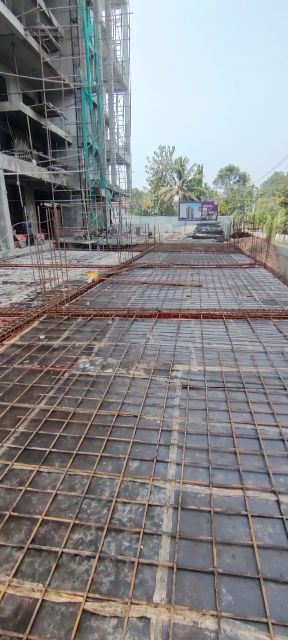

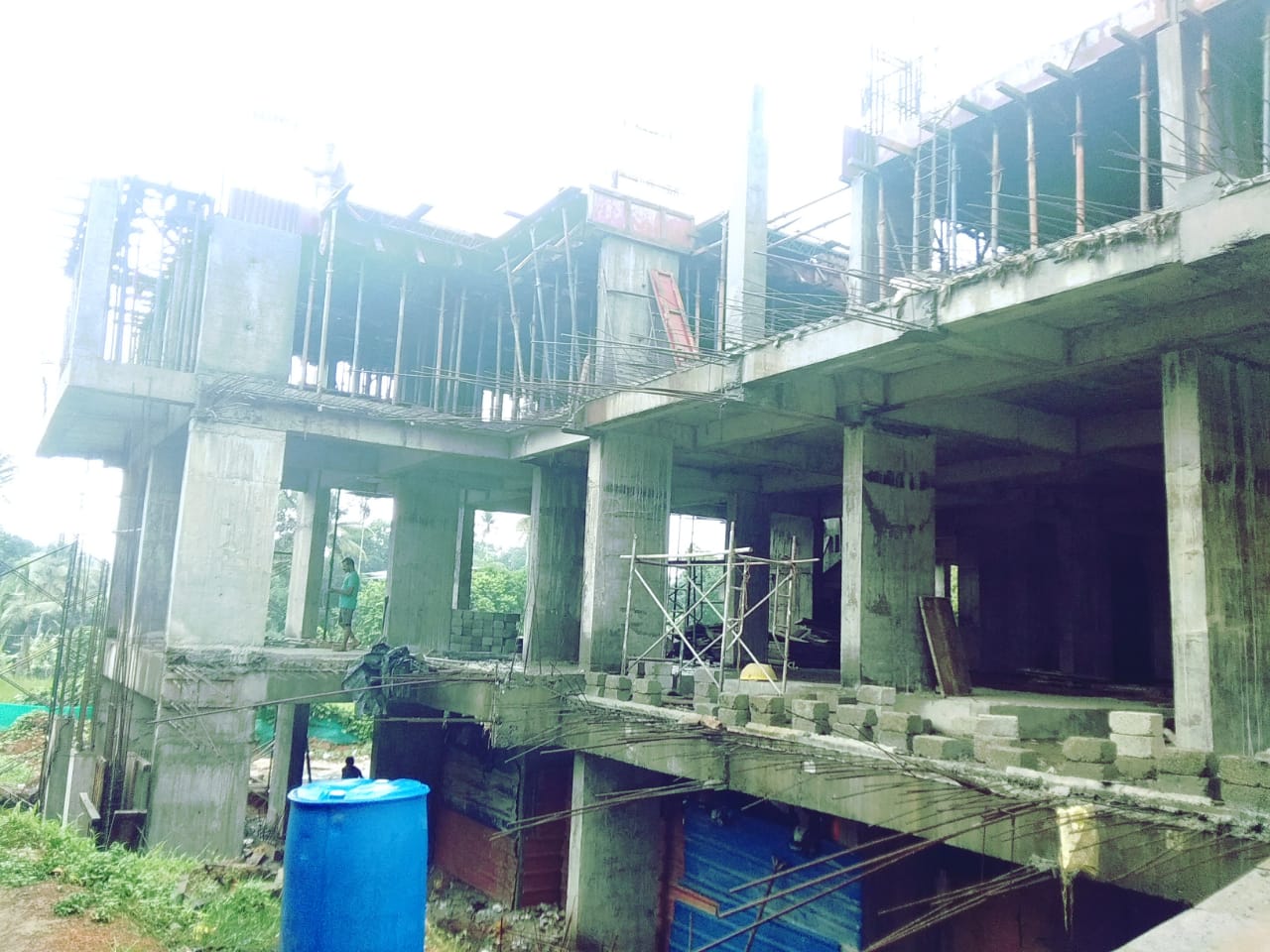

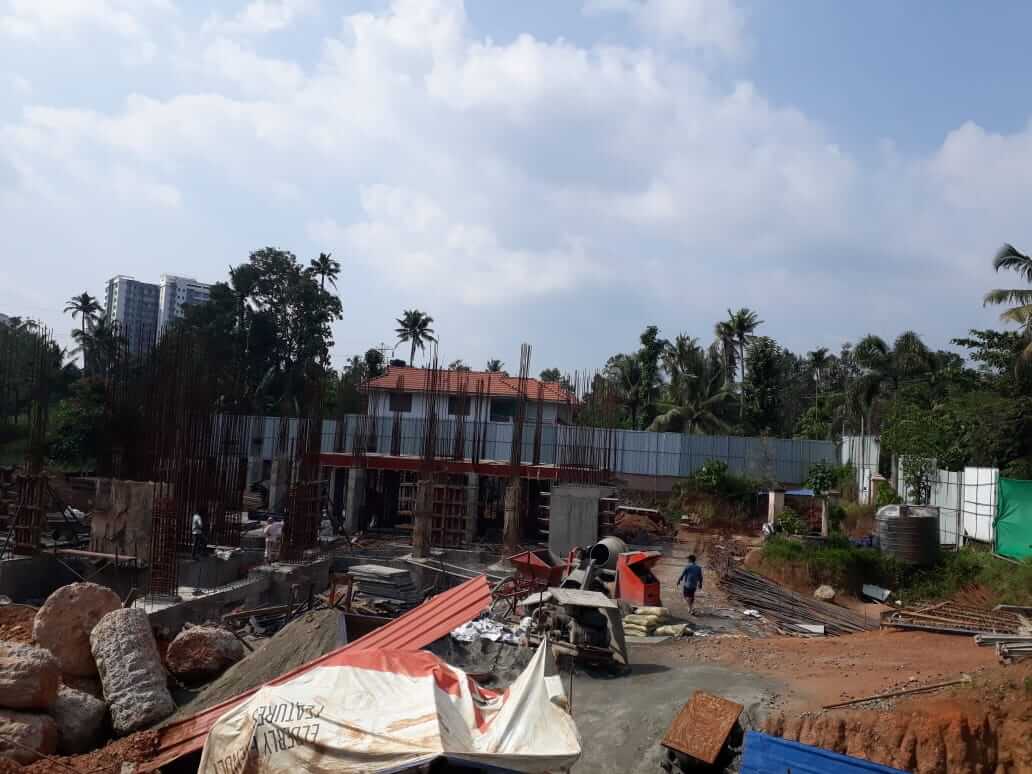

  • Structural Works – slab – ramp portion, drive way, Ground floor parking slab to be completed , Amenities ; Swimming pool ,childrens play area, OHT,SHR,LMR to be completed

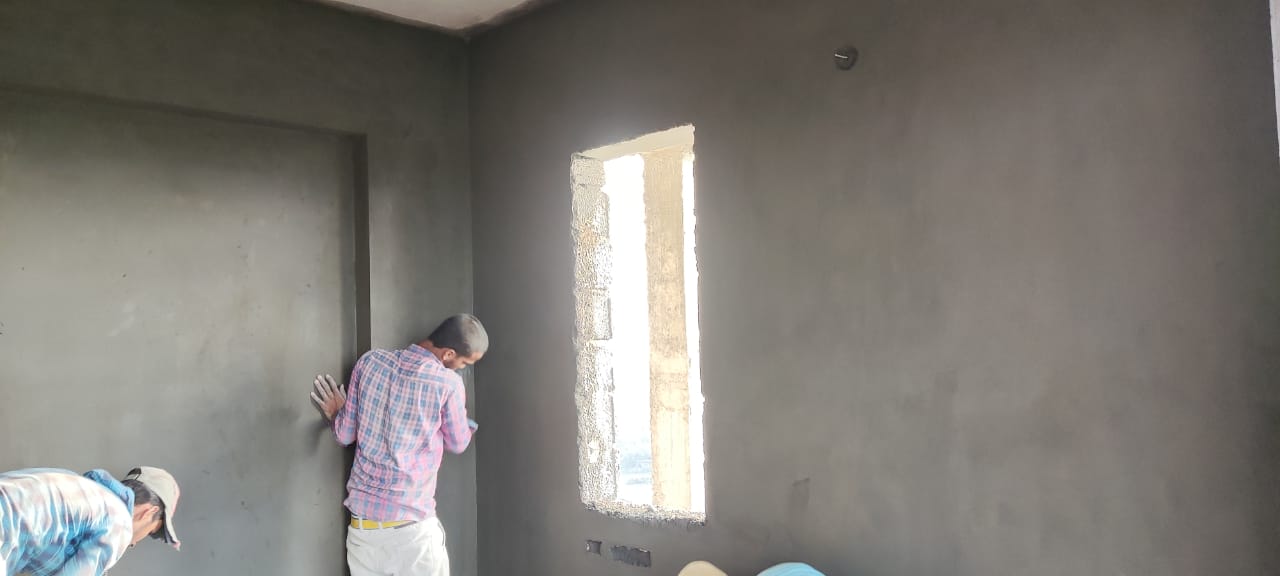

  • Civil Works – wall plastering -80% to be completed, block work- 20th floor 100% to be completed. Screeding – 20% to be completed, Internal plaster -15th, 6th floor 100% to be completed.
  • Internal Finishes – Water proofing – 50% to be completed, Door frame fixing 90% to be completed ( up to 19 th floor 100% to be completed)
  • Electrical, Plumbing & Firefighting works – Concealed plumbing work – 7th,8th,9th 10th floor -100% to be completed ,Corecutting upto 15th floor -100% to be completed , Firefighting works 7th, 8th, 9th floor -100% to be completed
  • External Finishes – Windows & Sliding doors – 30% to be completed, External Plastering – 40% to be completed

Work status as on 10-03-2022, we have completed the following.

  • Structural Works – Pile cap – 80% completed, slab – 95% completed
  • Civil Works – Ceiling plastering – 96% completed (till 17th floor), Masonry – Block/ brick -80% completed (till 14th floor) , Internal plaster -70% completed (till 13th floor)

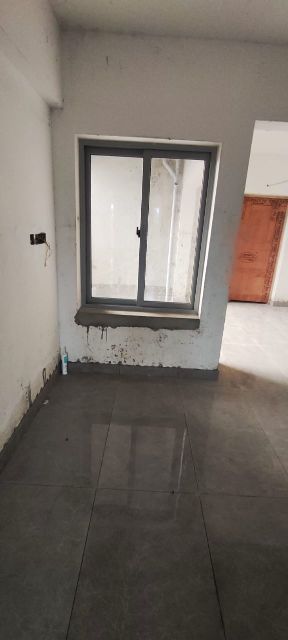

  • Internal Finishes – Main door – 2% completed (sample flat only),Wall tiling – 2% completed (sample flat only) , Flooring – 3% completed (sample flat only), putty works & Painting – putty 40% completed(till 7th floor), primer (8th,9th,10th,11th floor completed), Door frame fixtures -75% completed (up to 14th floor completed), Handrails -10% completed (GF to sample flat completed), Water proofing – 10% completed (till 4th floor)
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works- 30% completed (till 3th floor), Centralised Gas piping system- 5% completed (mock up only), Firefighting final fixtures – 20% completed (till 6th floor)
  • External Finishes – Windows & Sliding doors – 5% completed (mockup only), External Plastering – 15% completed (front side) , External Painting – 2% completed (mock up only)
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer application 100% completed , First coat painting 100% completed ,Final coat painting 100% completed

As per the current work status from our site, we are targeted to complete the following works by the end of MARCH 2022.

  • Structural Works – Amenities; Swimming pool, children’s play area, OHT, SHR, LMR to be completed
  • Civil Works – Ceiling plastering- 100% to be completed, wall plastering -75% to be completed, blockwork- 85% to be completed.
  • Internal Finishes – Waterproofing – 30% to be completed, Door frame fixing 80% to be completed ( up to 19th floor to be completed)
  • Electrical, Plumbing & Firefighting works – Concealed plumbing work – 6th 7th floor -100% to be completed,Corecutting upto 12th floor -100% to be completed, Firefighting works 7th, 8th, 9th floor -100% to be completed

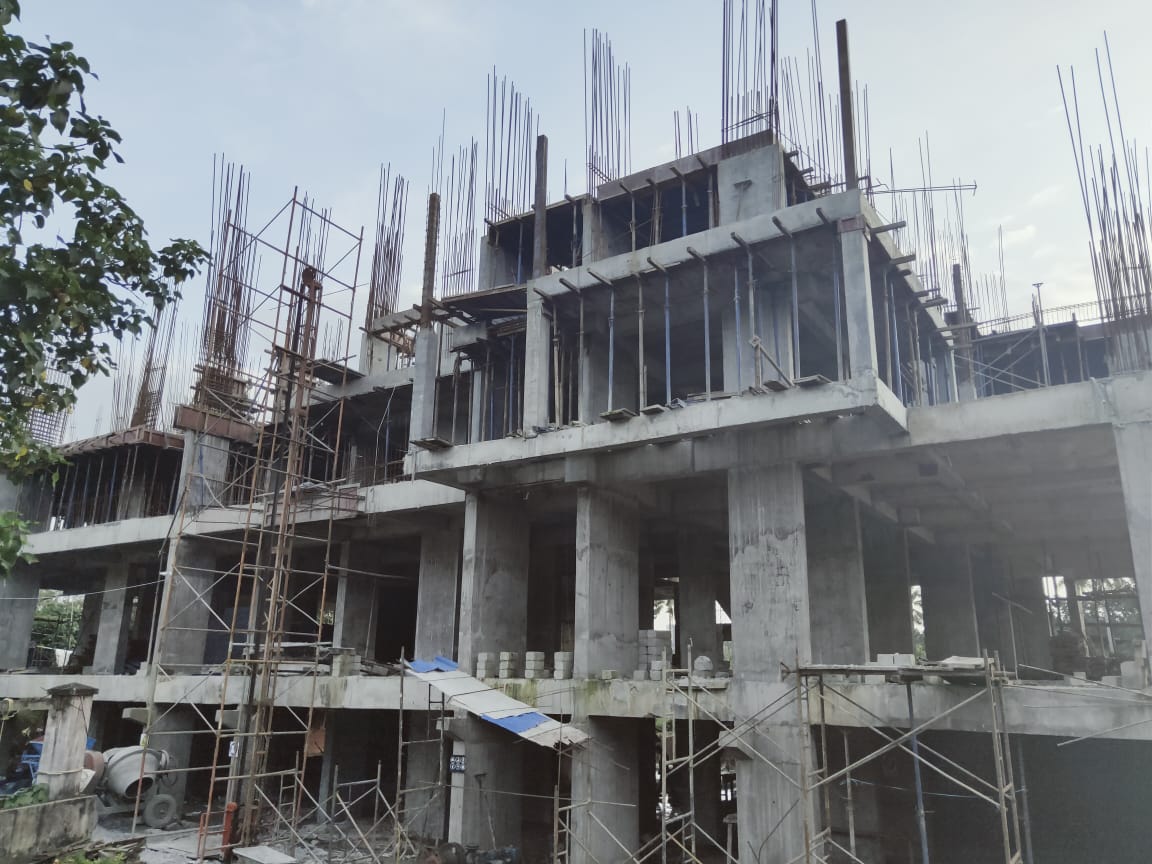

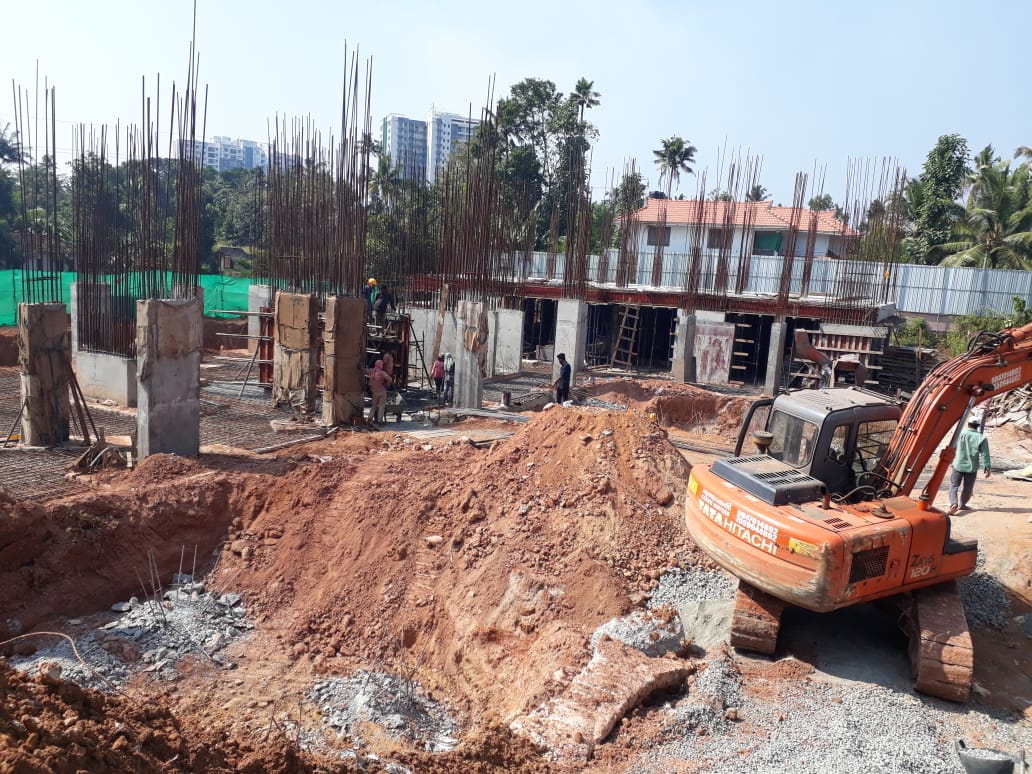

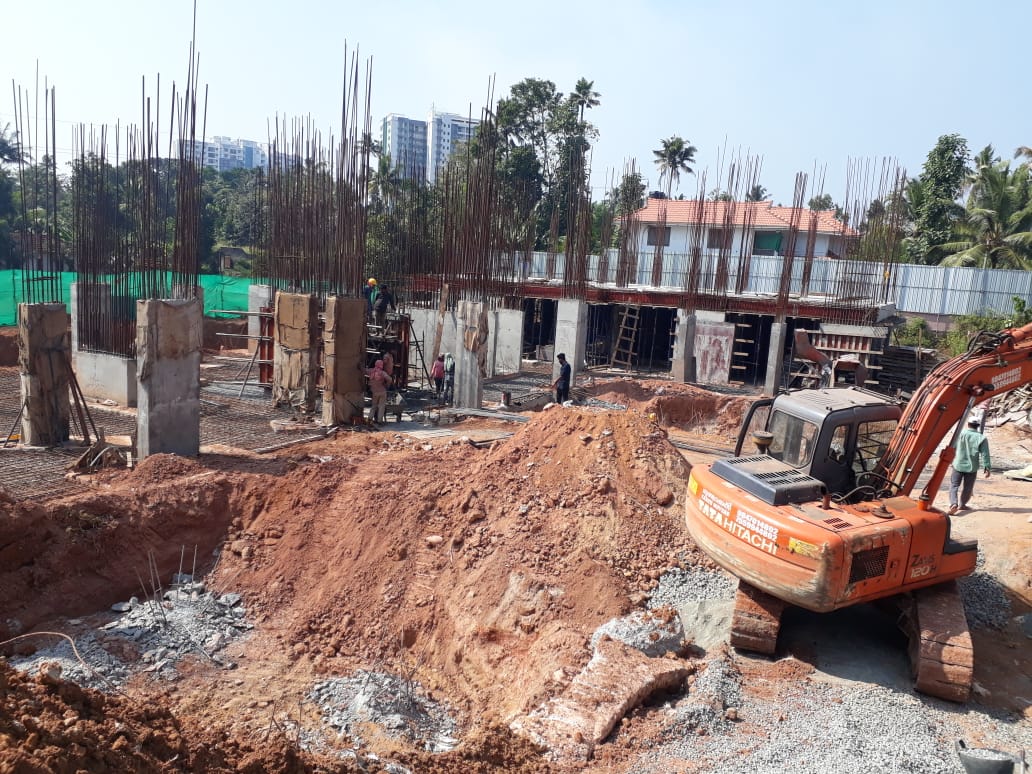

Work status as on 09-04-2021, we have completed the following.

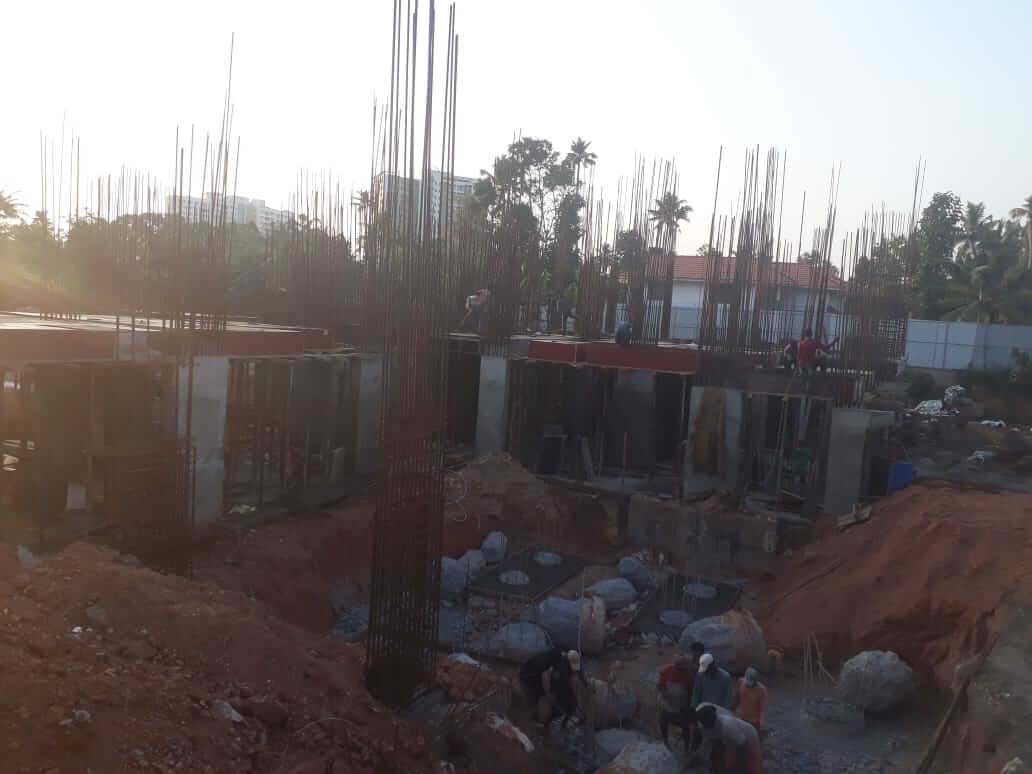

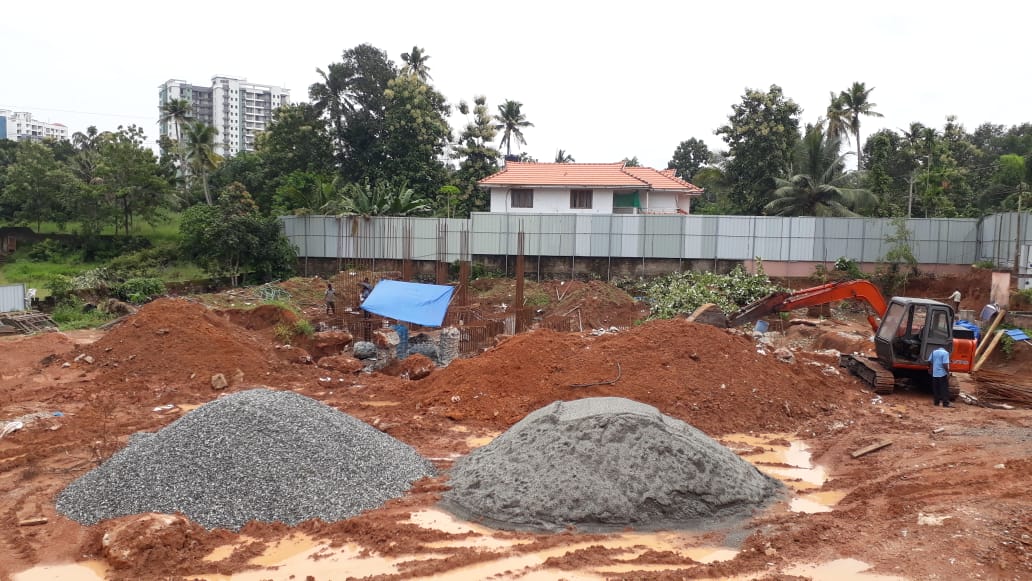

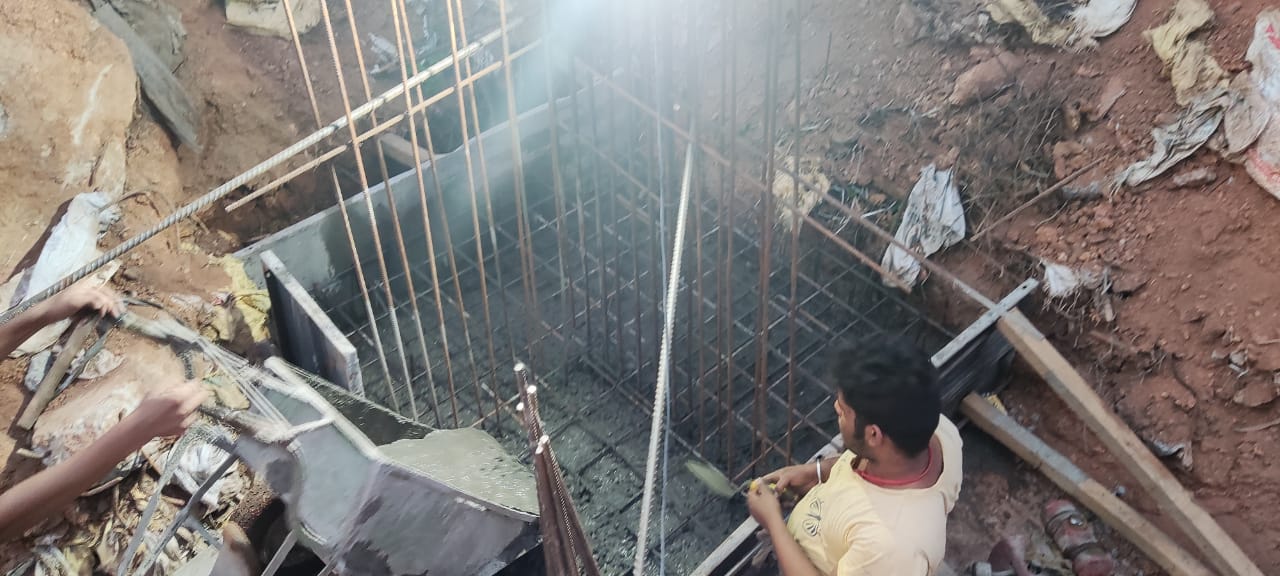

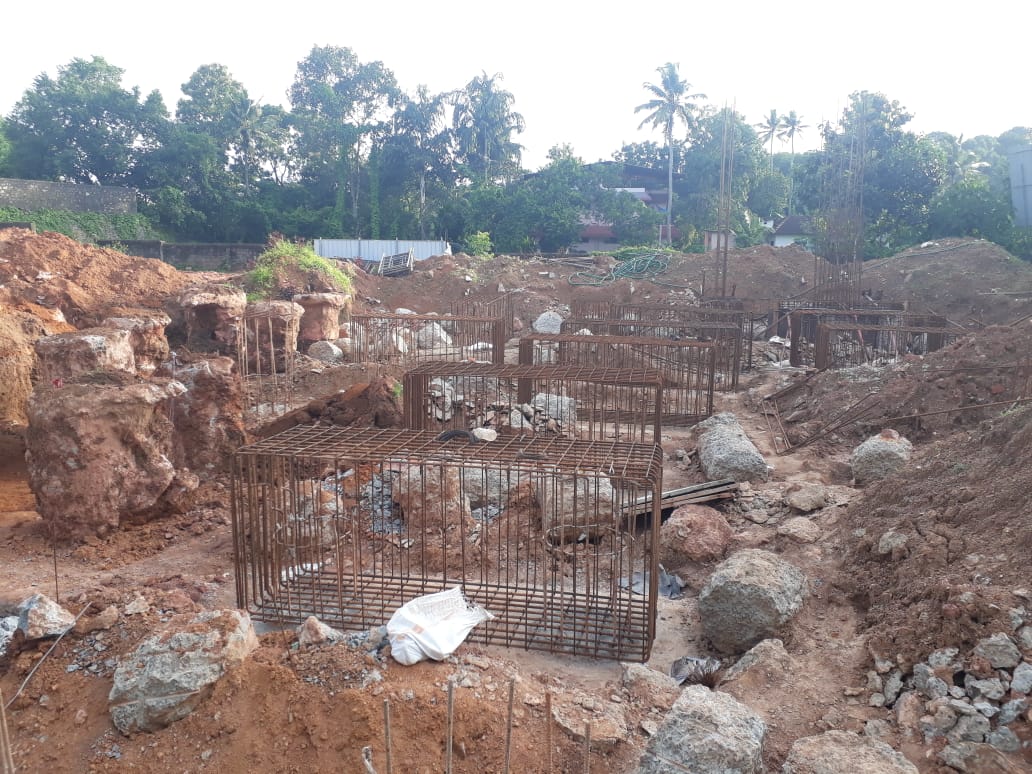

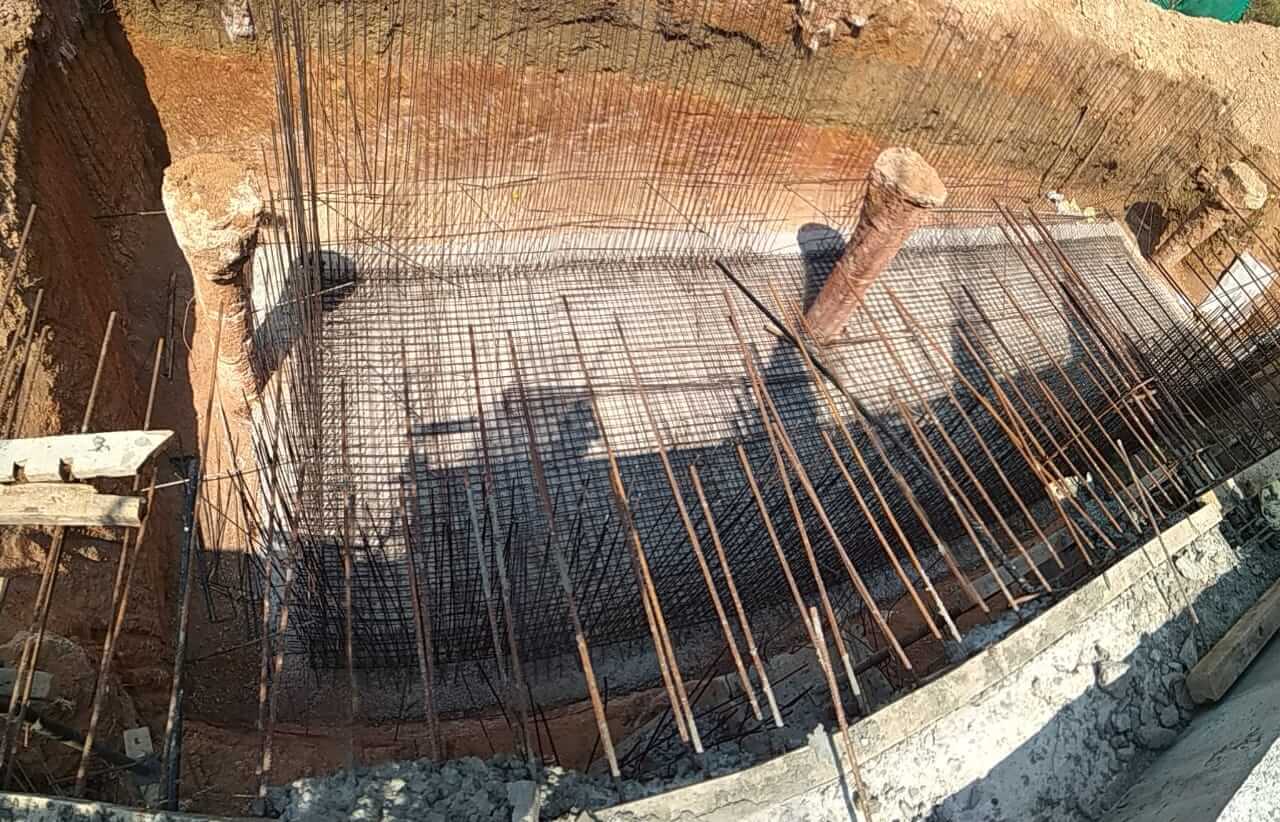

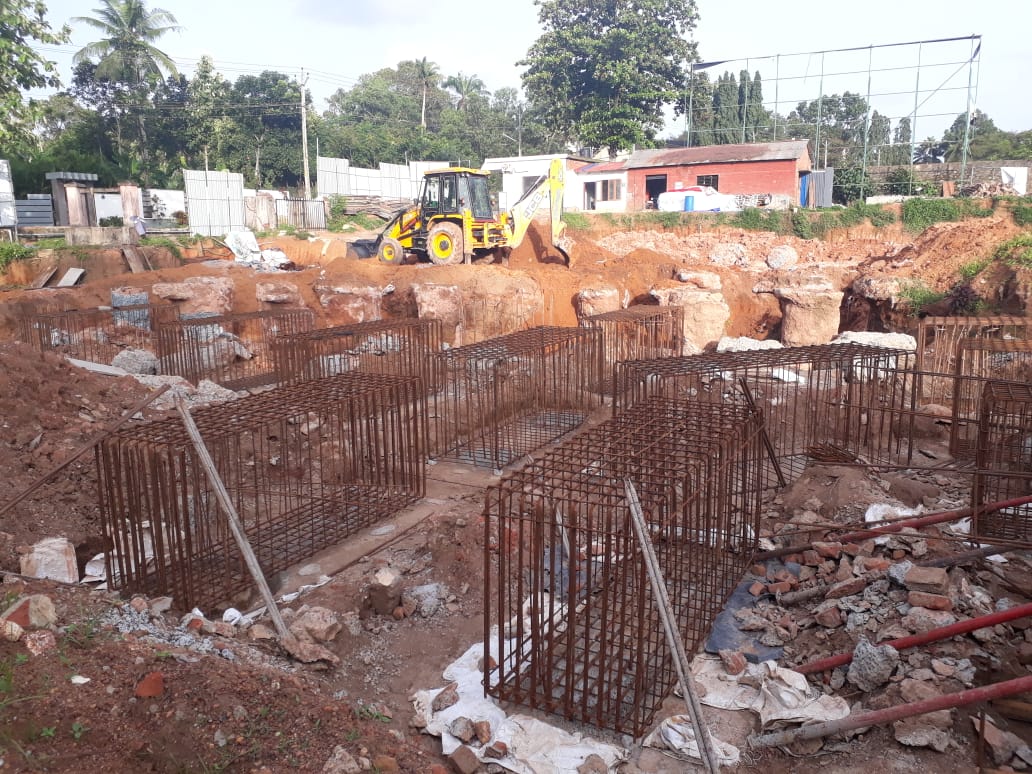

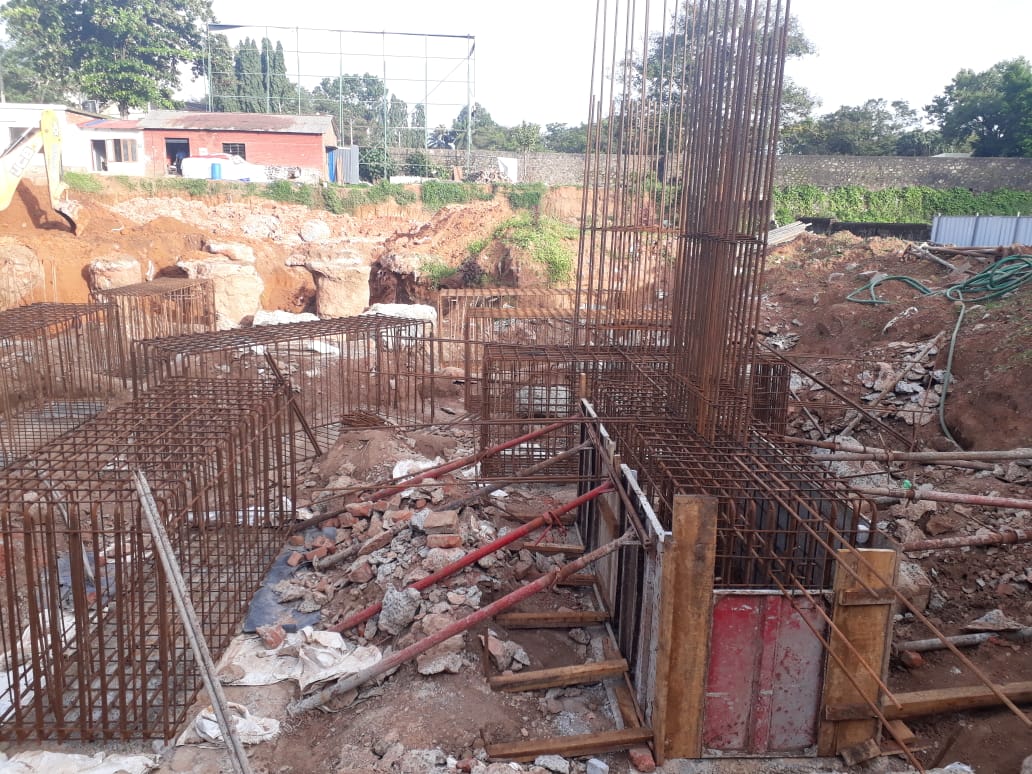

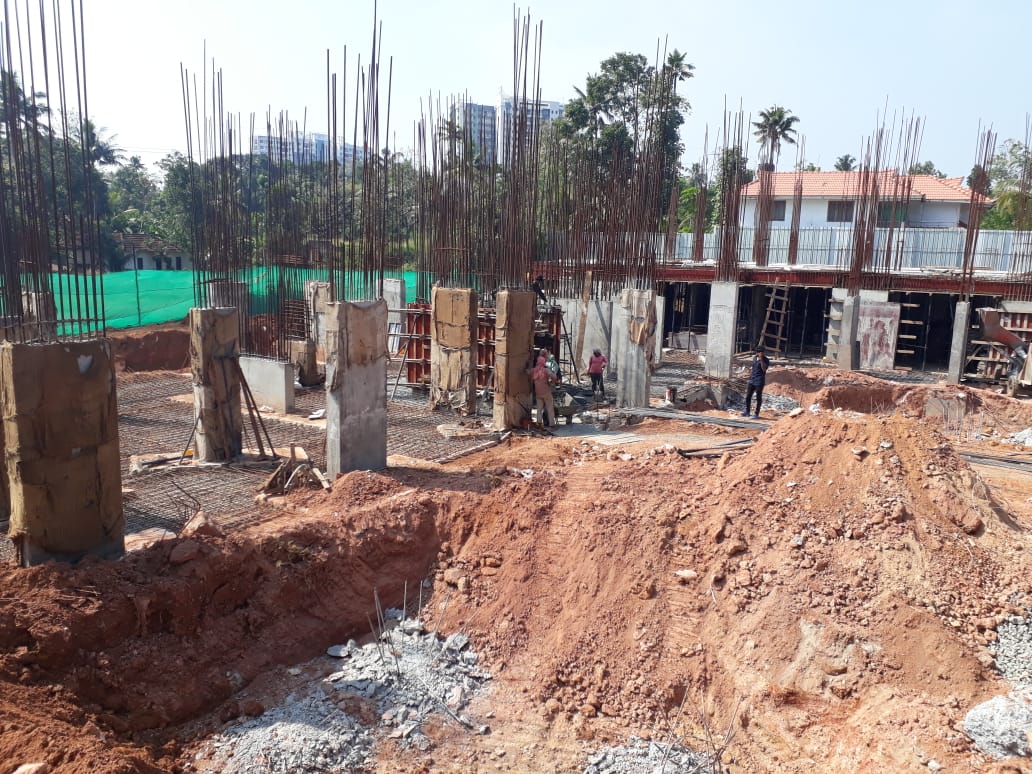

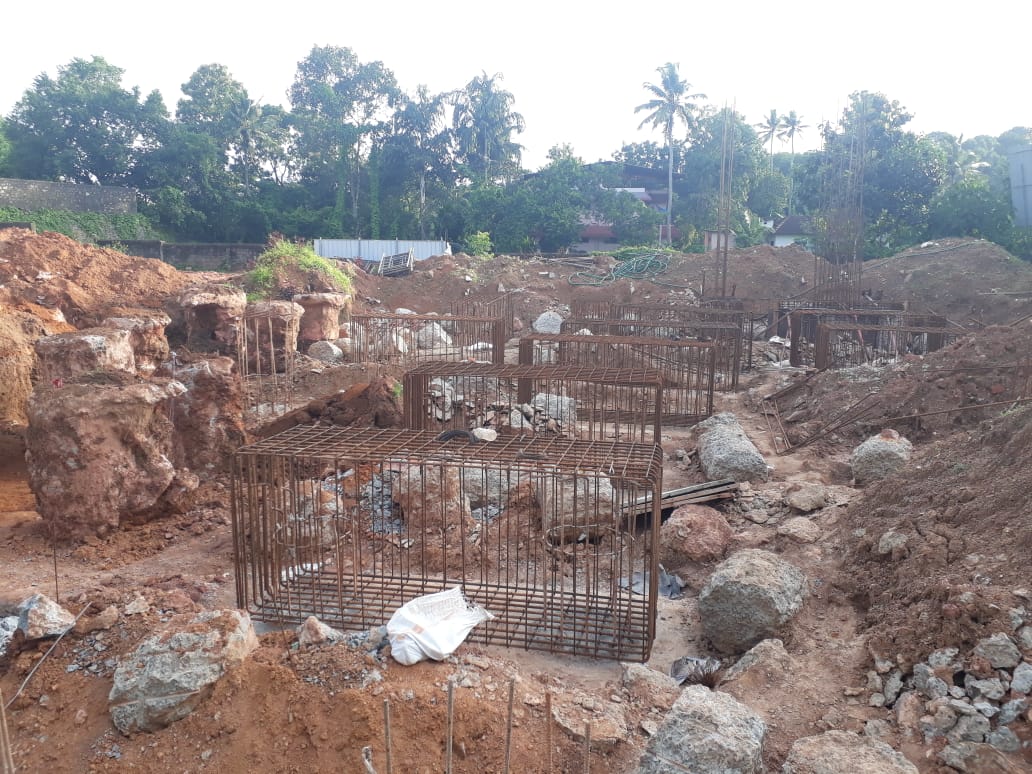

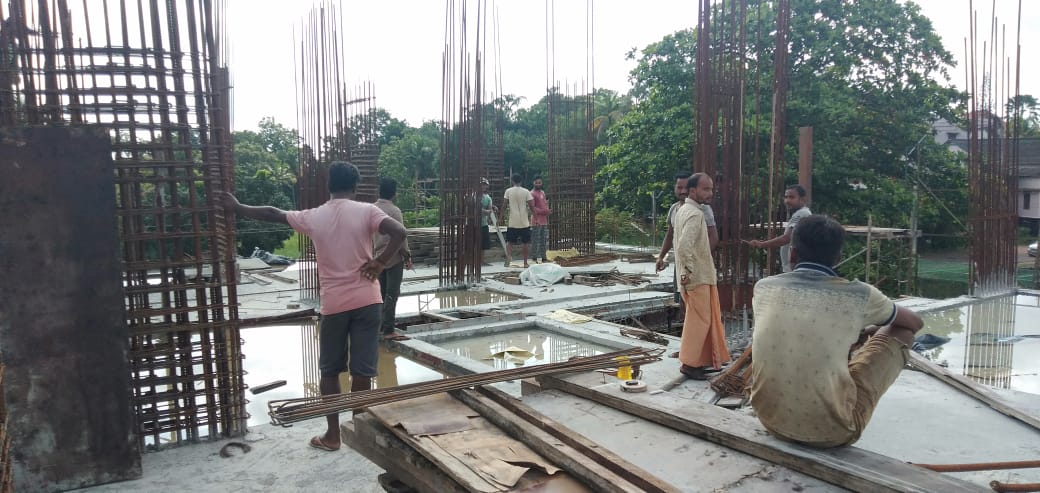

  • Earth work excavation for piling :89% completed

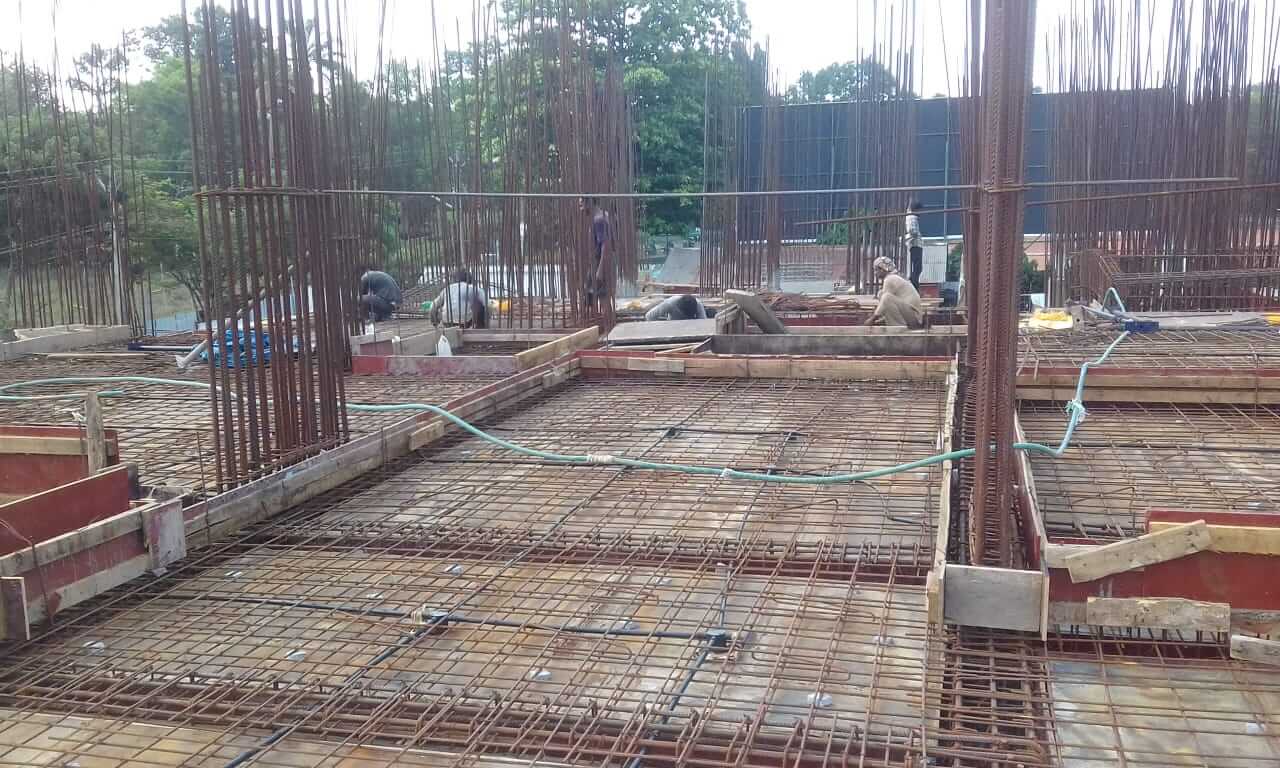

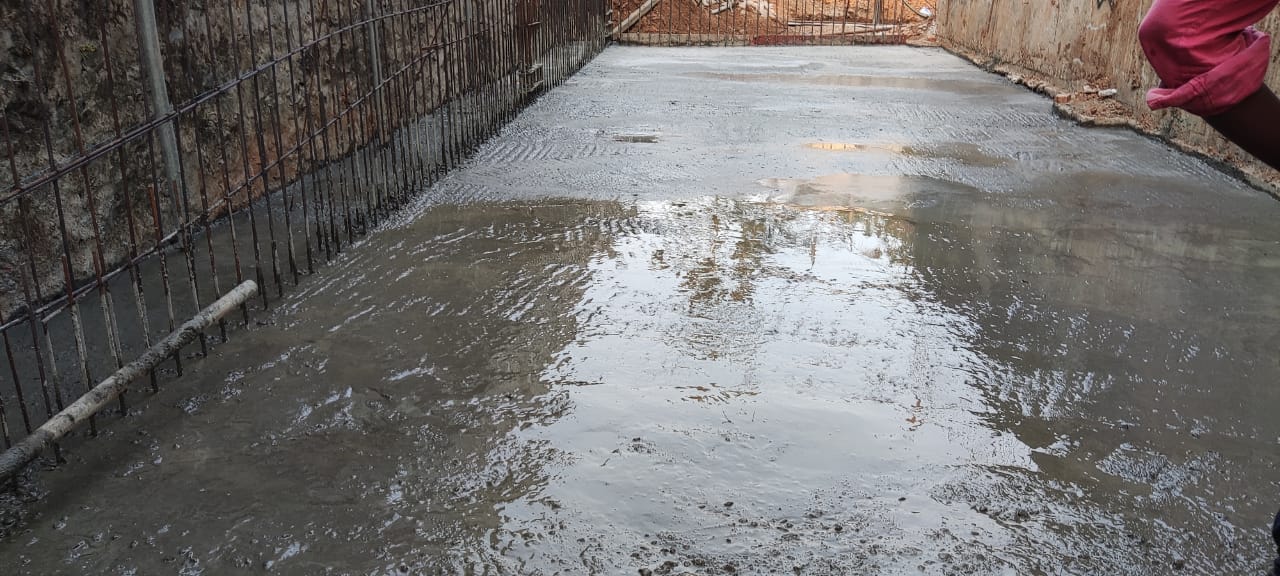

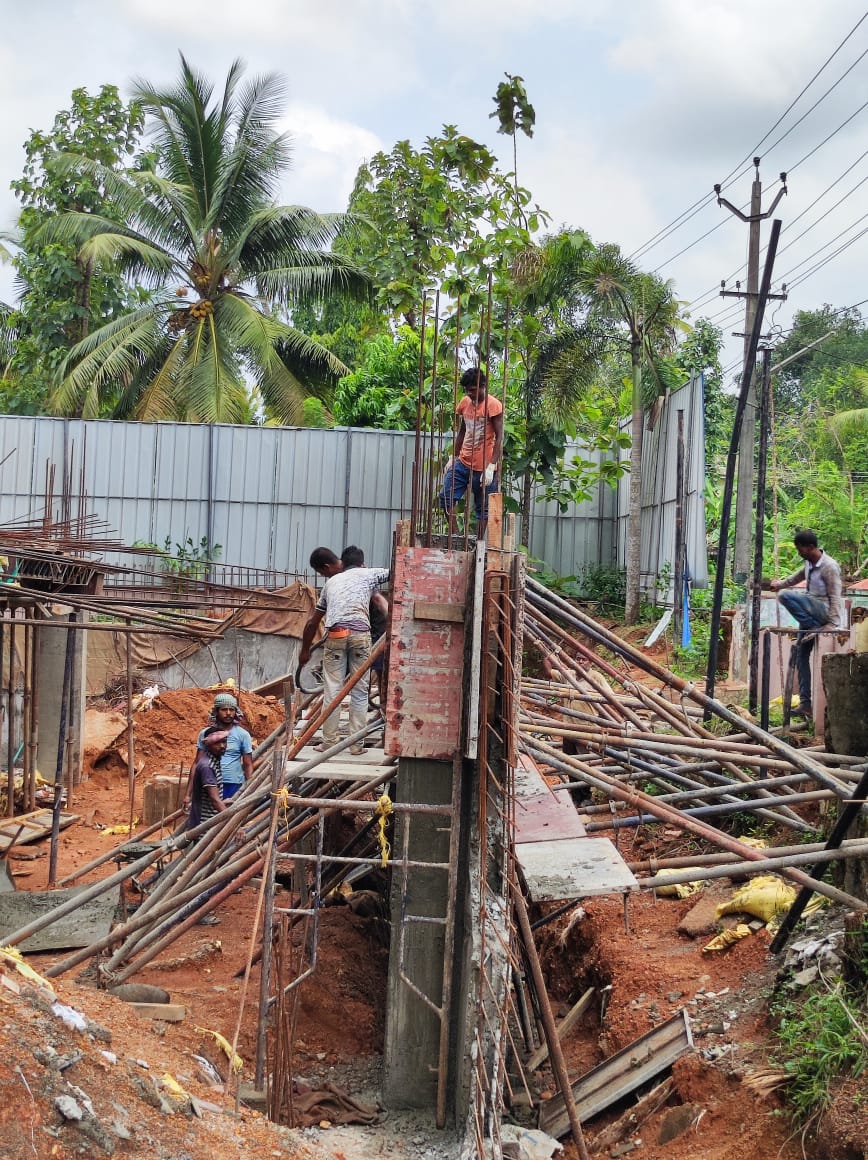

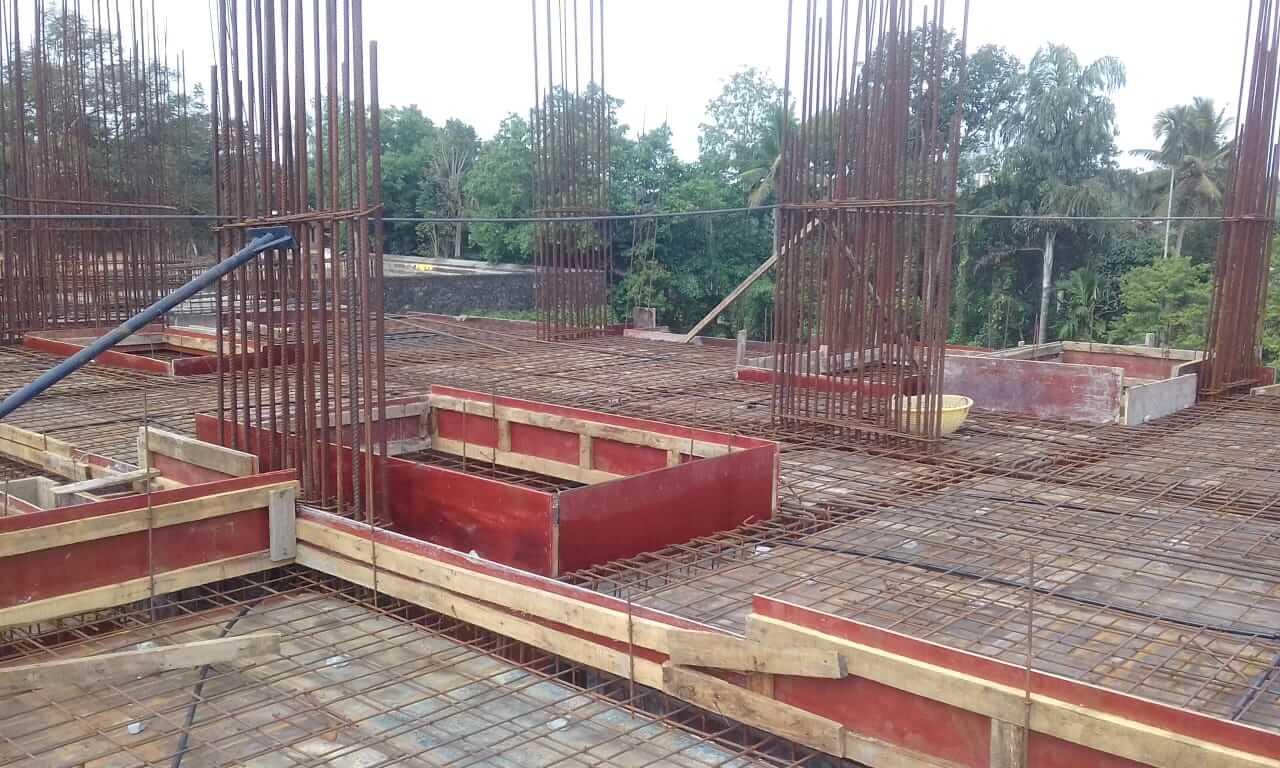

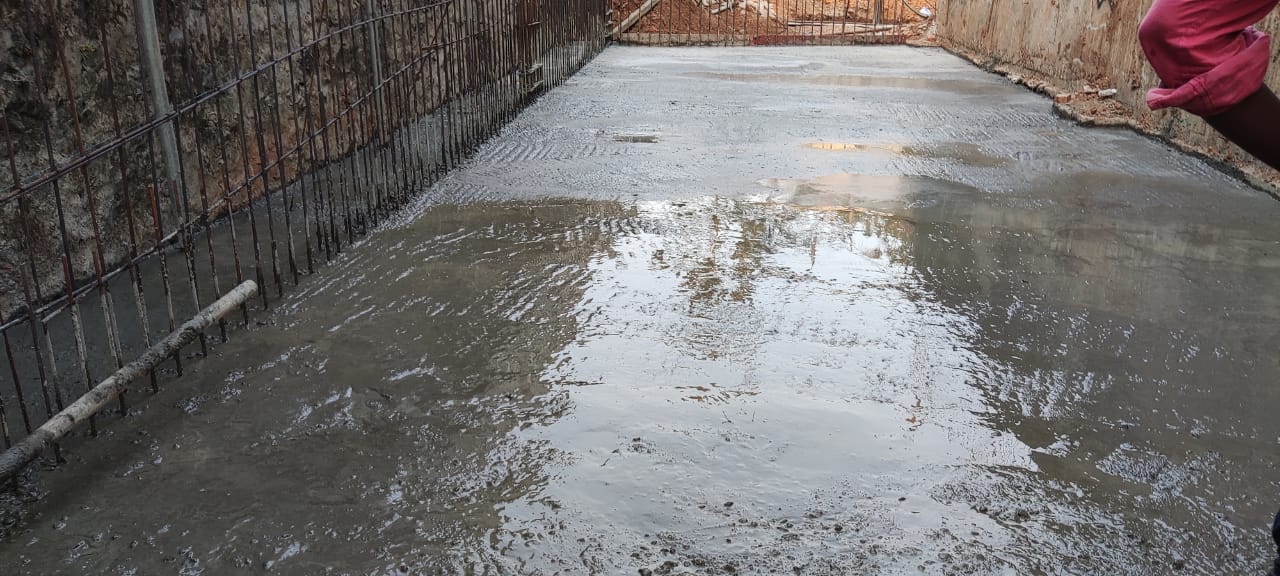

  • Pile cap RCC work – 84% completed

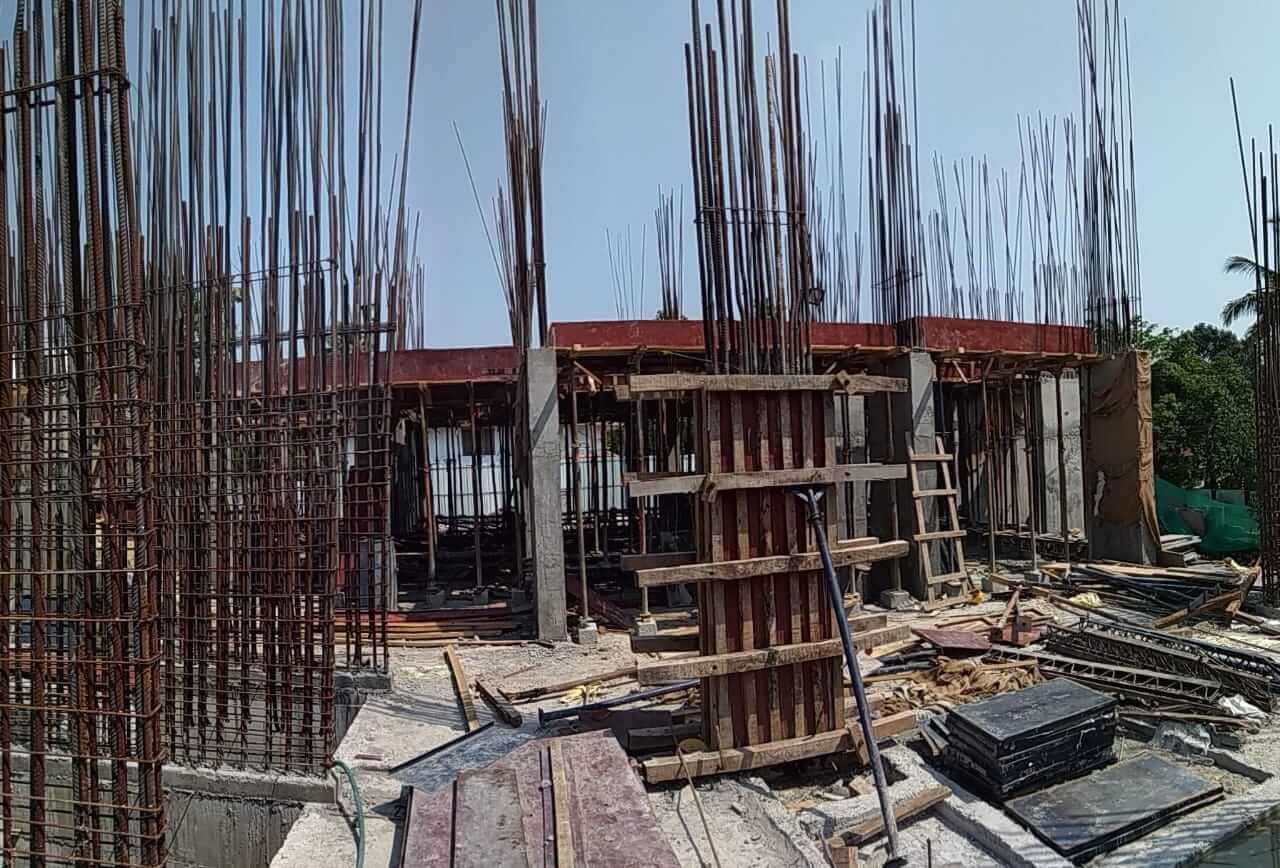

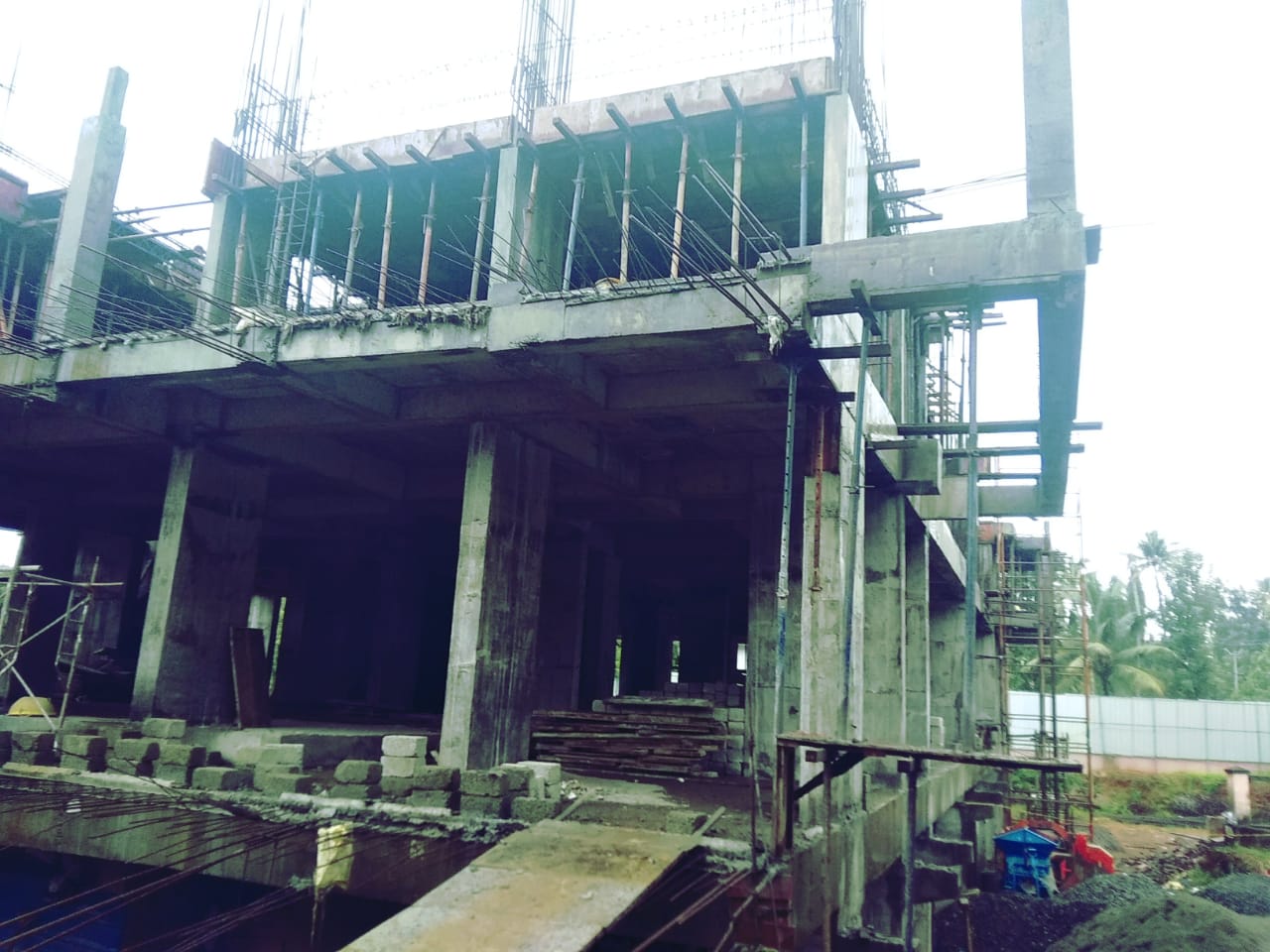

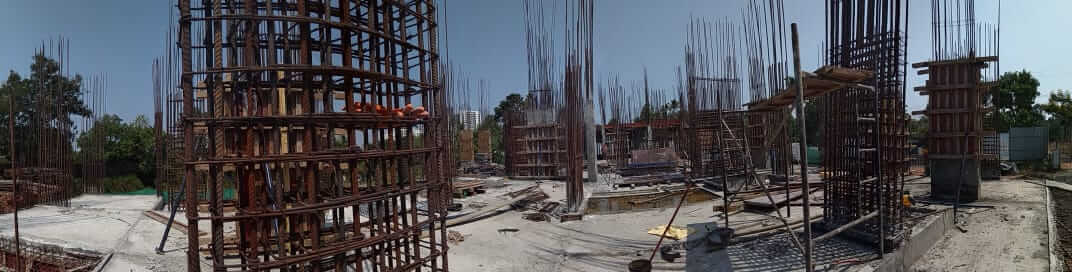

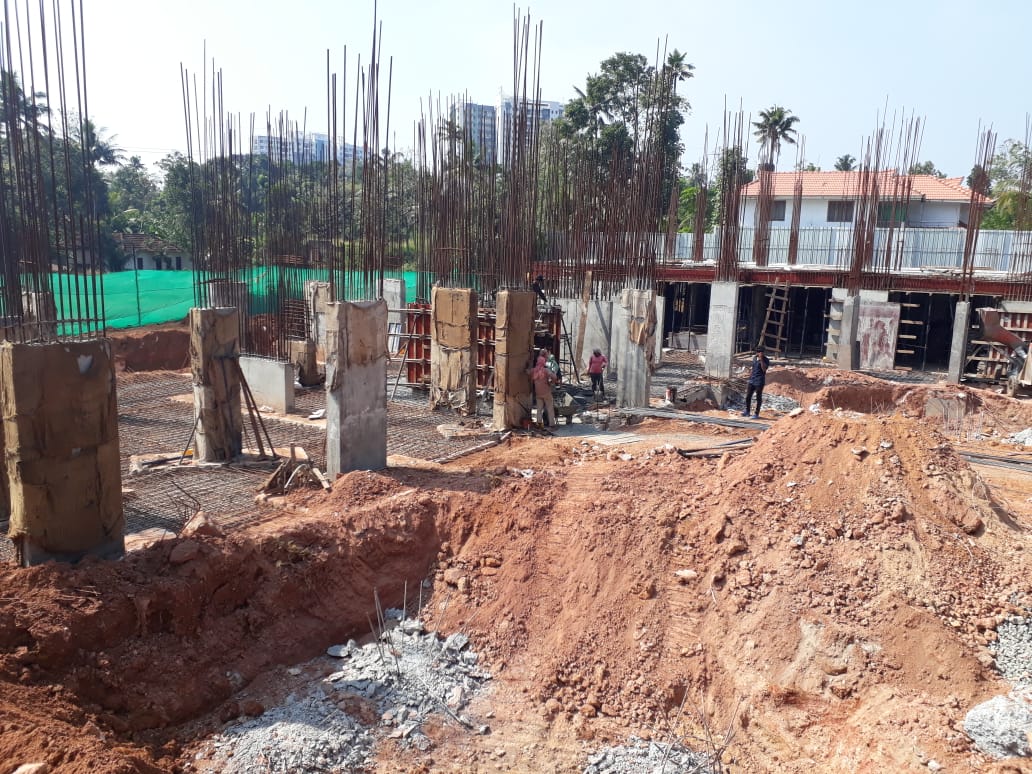

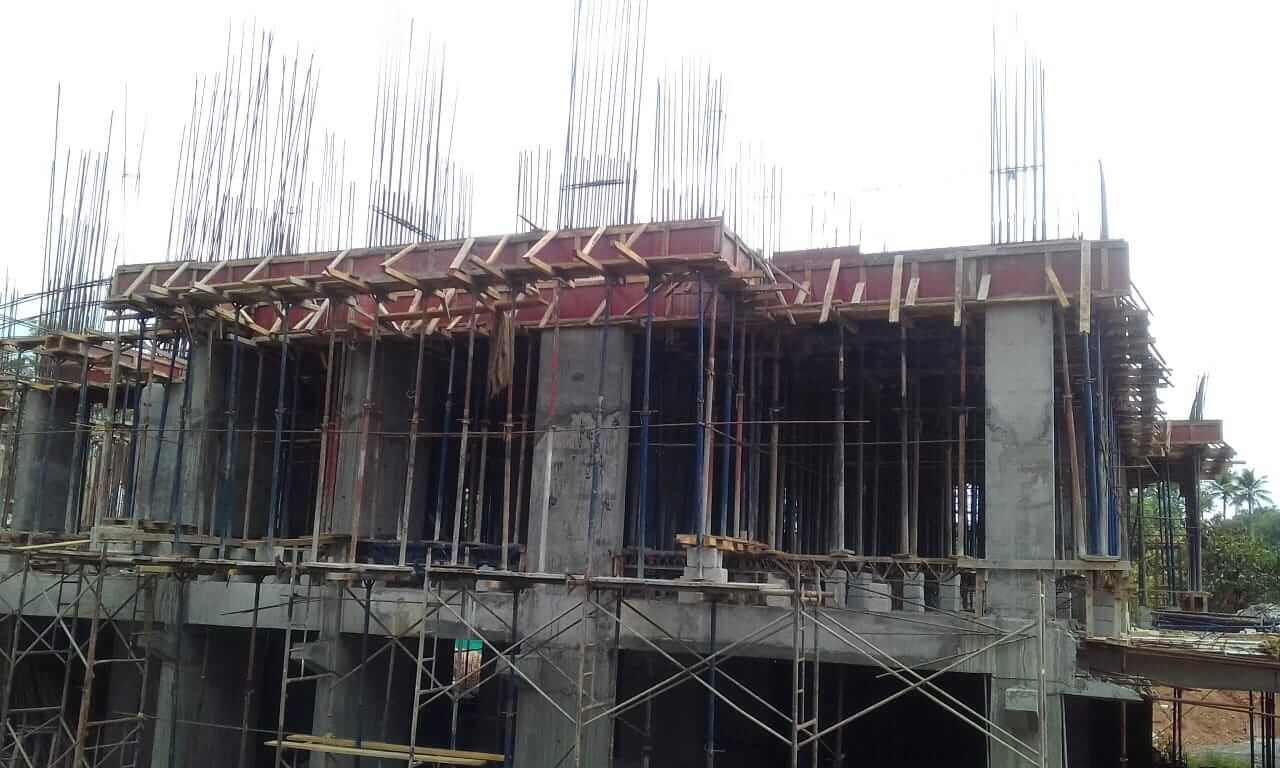

  • Beam and Slab Work :BF-60% completed,GF-40% completed,1st floor -15th floor:100% completed ,16th floor-50% completed.

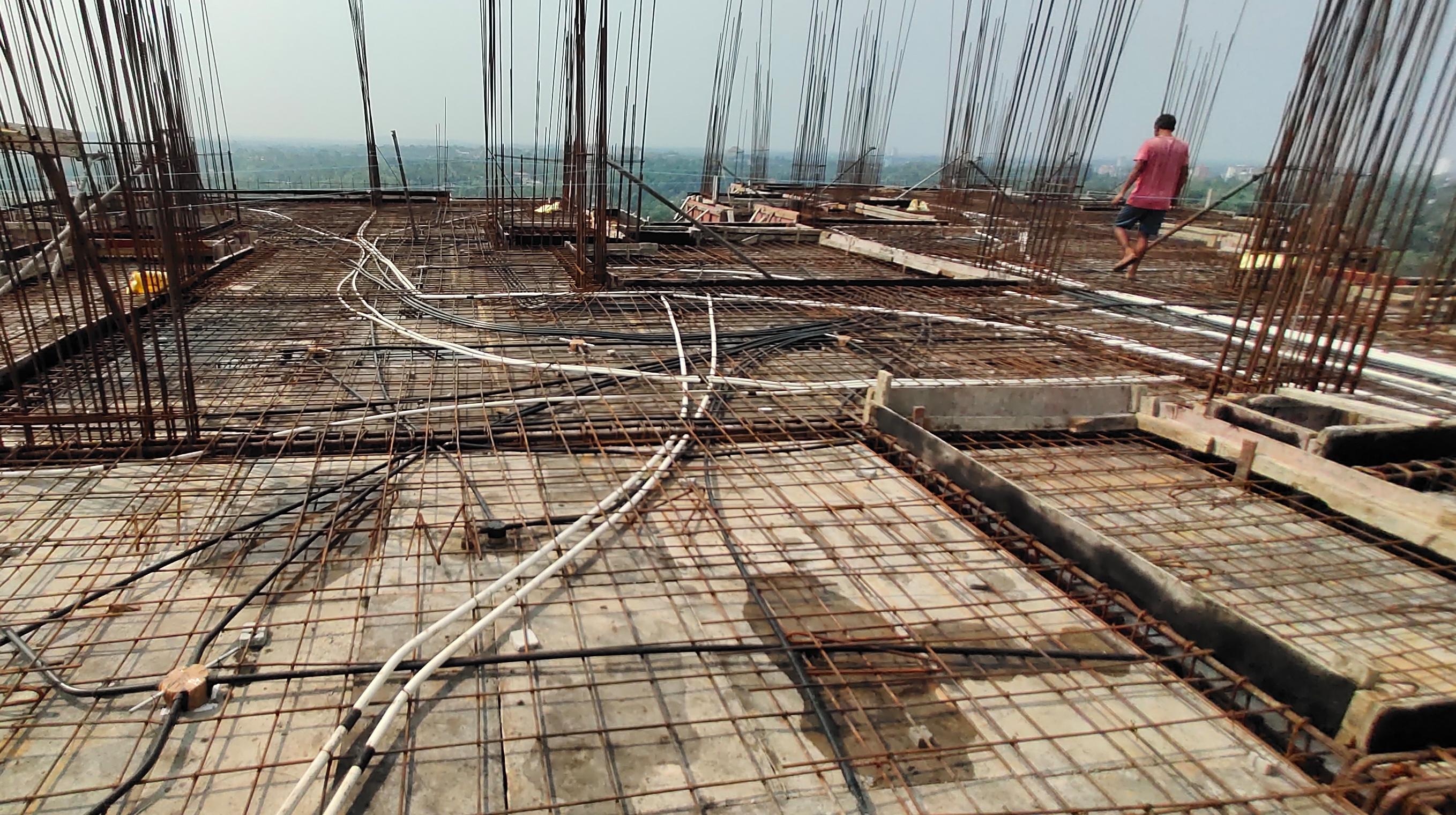

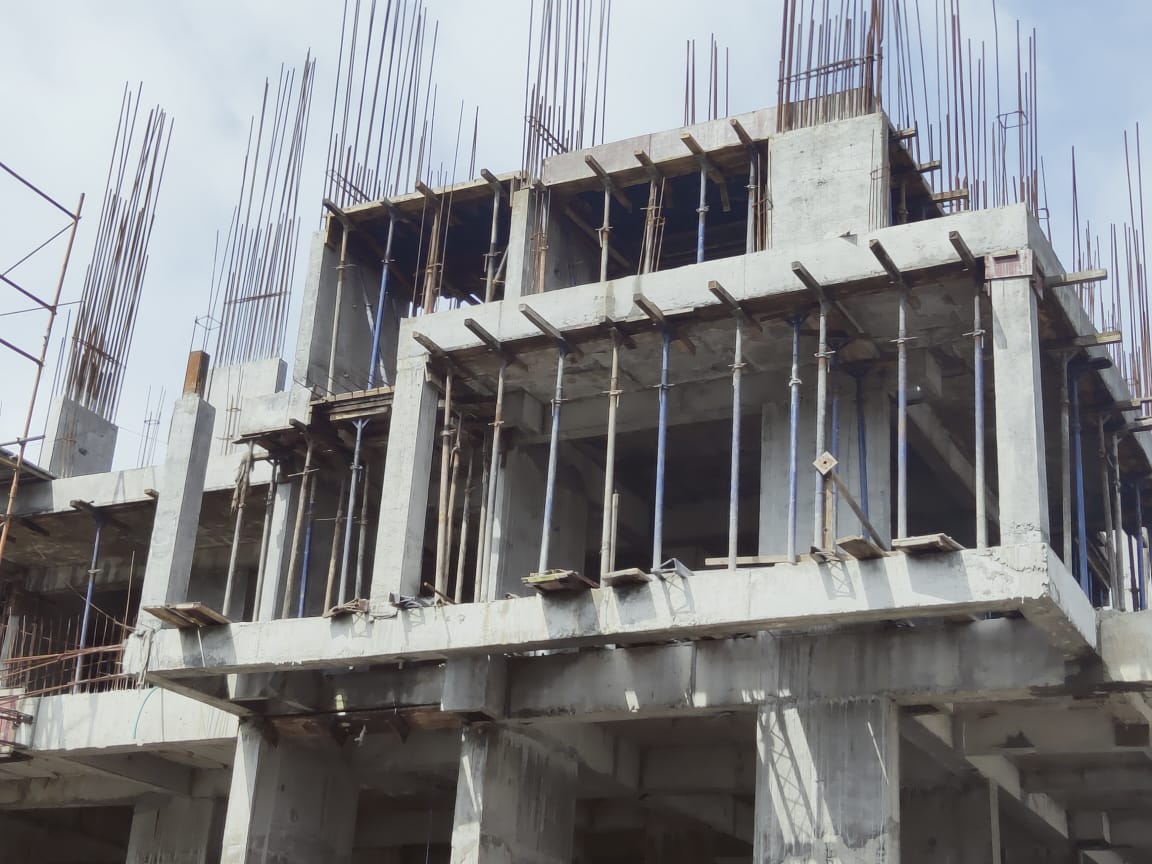

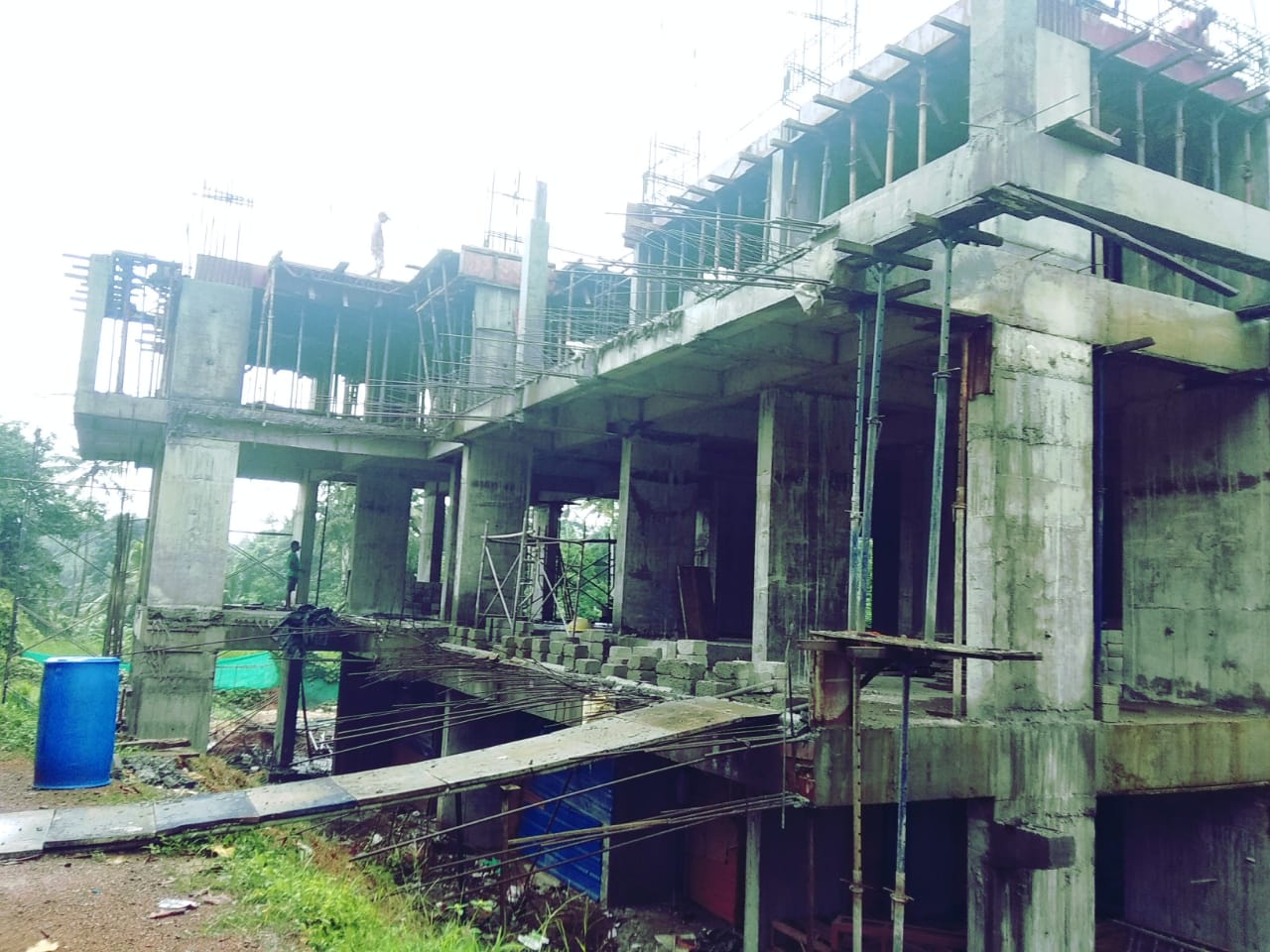

  • Column Work :BF-58% completed,GF-15th Floor -100% Completed ,16th floor-40% completed.
  • Ceiling plastering work:
    • Ground floor :Ceiling 75% completed
    • 1st floor-10th floor :- 100% completed
  • Blockwork:2nd floor:- 95% completed, 3rd floor- 6th floor -95% completed,7th floor-80% completed.
  • Wall plastering:2nd floor -4th floor-100% completed,5th floor-10%completed.
  • Putty & Primer works:2nd floor – 20% completed
  • Plumbing work:2nd Floor:-20% completed.
  • Tiling work :
  • Door frame fixing:2nd floor-6th floor :-100% completed.
  • Electrical chasing : 2nd floor-4th floor:-100% completed, 5th floor -40% completed

As per the current work status from our site, we are targeted to complete the following works by the end of APRIL 2021.

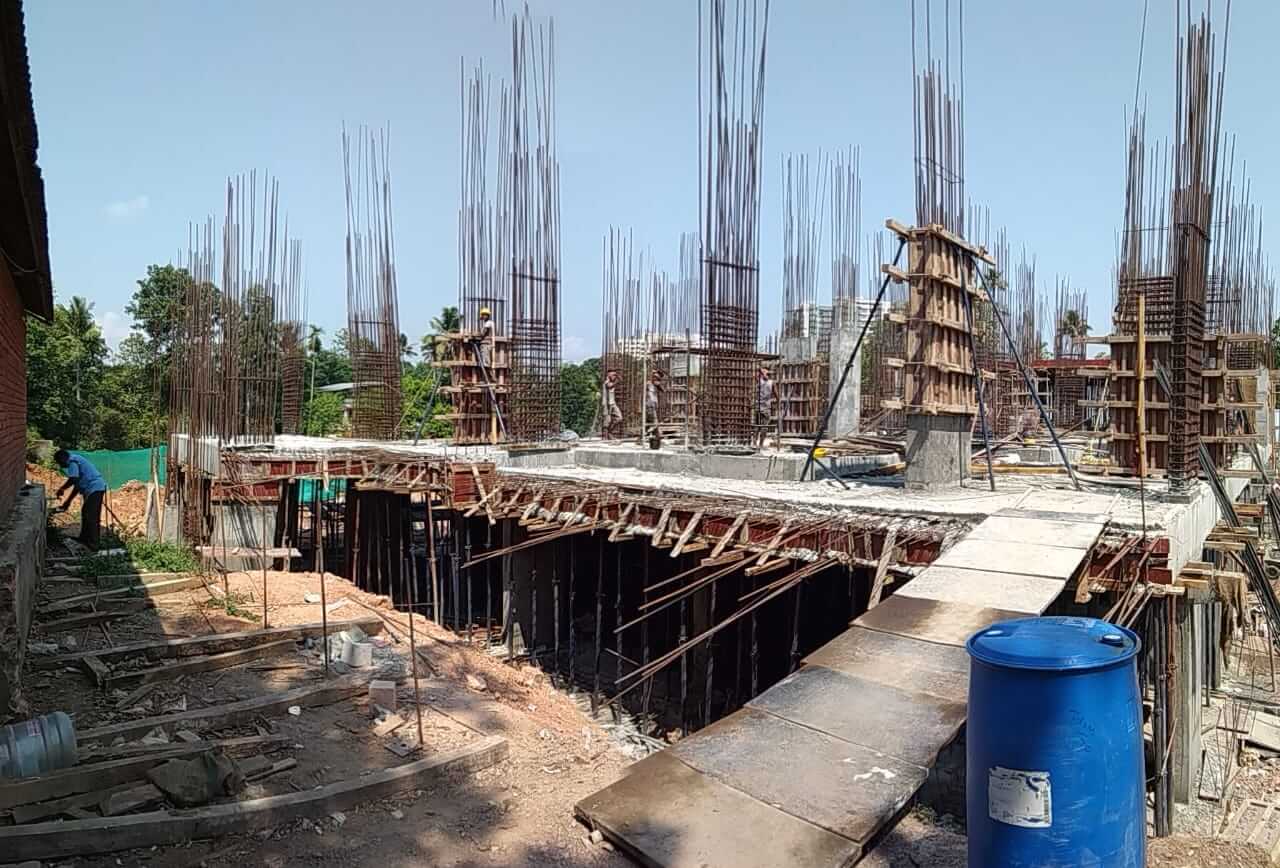

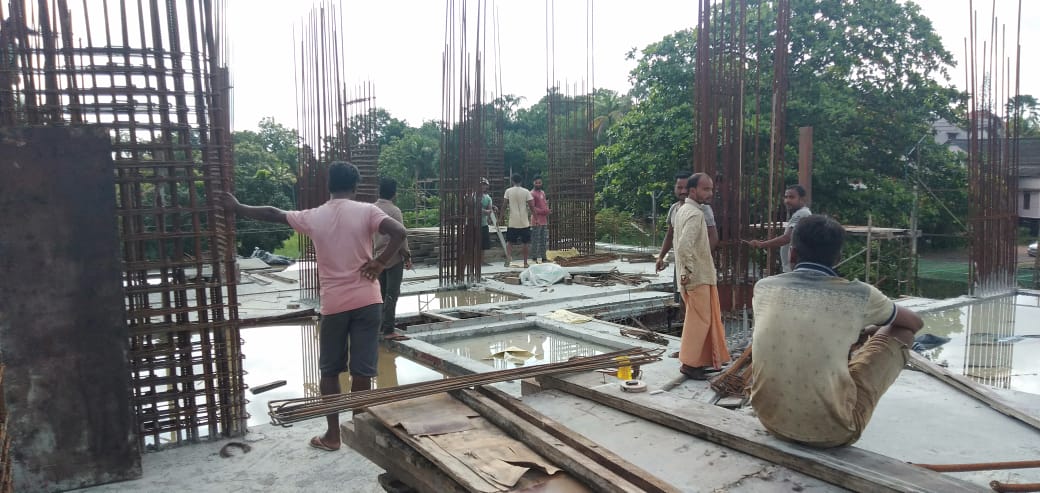

  • Beam and Slab Work :16th floor -100% to be completed, 17th floor- 50% to be completed.
  • Column Work :16th floor -100% to be Completed,17th floor-50% to be completed.
  • ceiling plastering work:11th floor: 100% to be completed
  • Blockwork:7th floor-100 %to be completed, 8th floor:- 50% to be completed
  • Wall plastering:5th floor:-100% to be completed
  • Putty & Primer works
  • Tiling work :sample flat:- 100% to be completed
  • Electrical chasing : 5th floor -100% to be completed

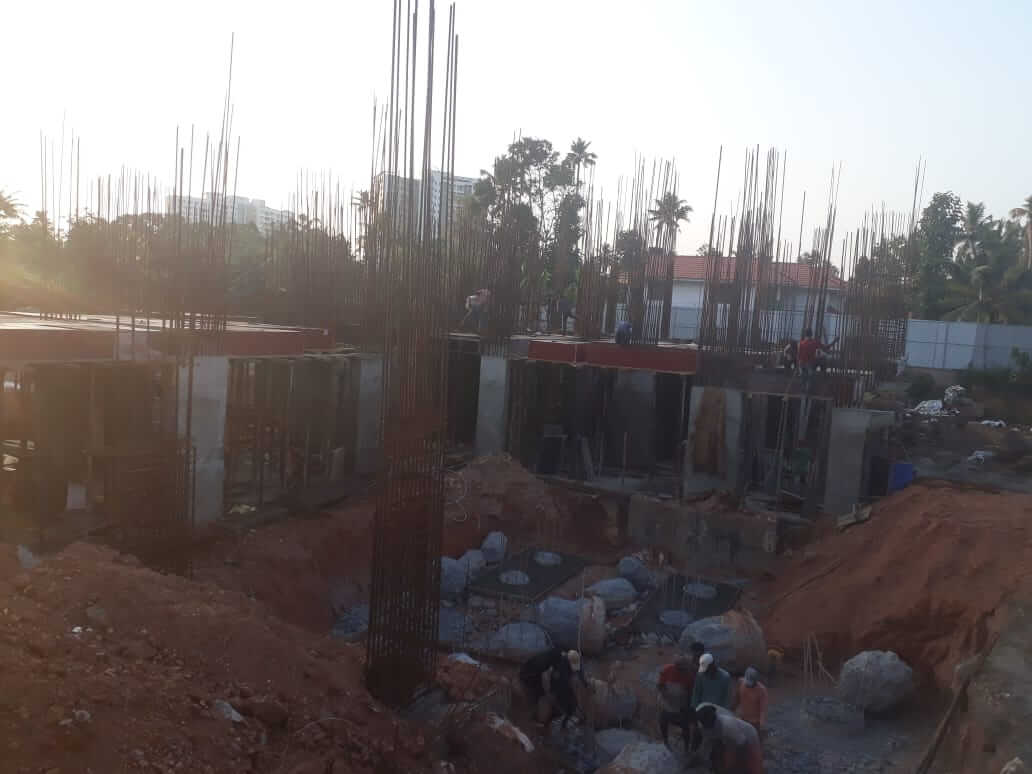

Work status as on 11-03-2021, we have completed the following.

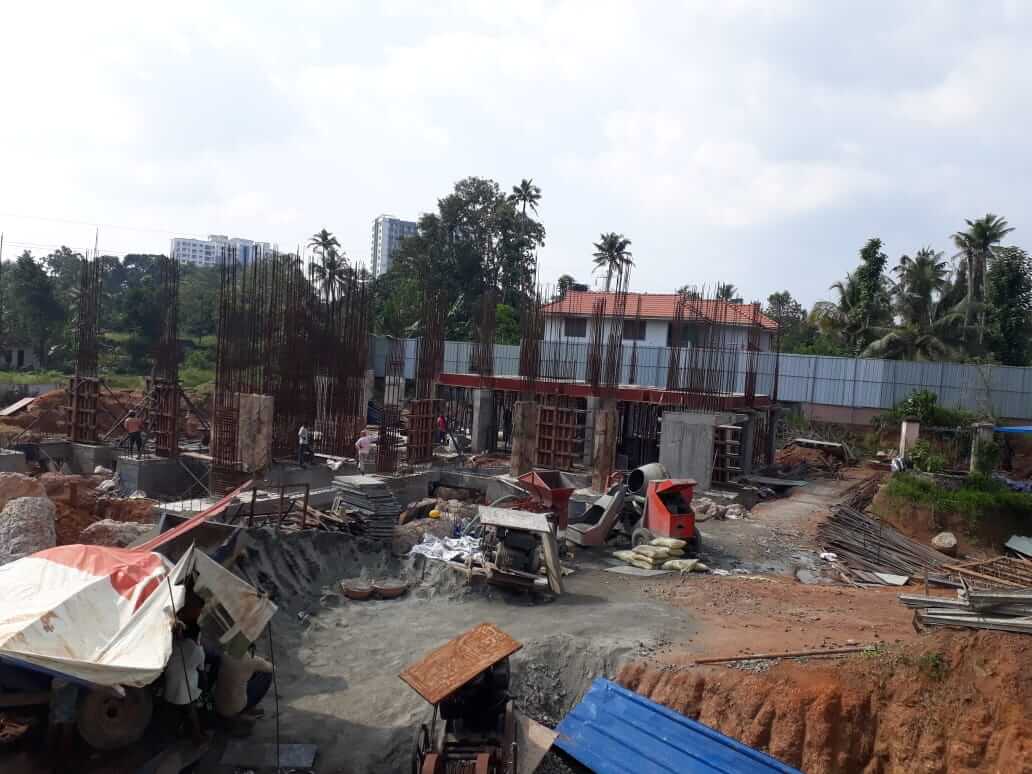

  • Earth work excavation for piling :89% completed
  • Pile cap RCC work – 84% completed
  • Beam and Slab Work : BF-60% completed,GF-40% completed,1st floor -14th floor:100% completed ,15th floor-50% completed

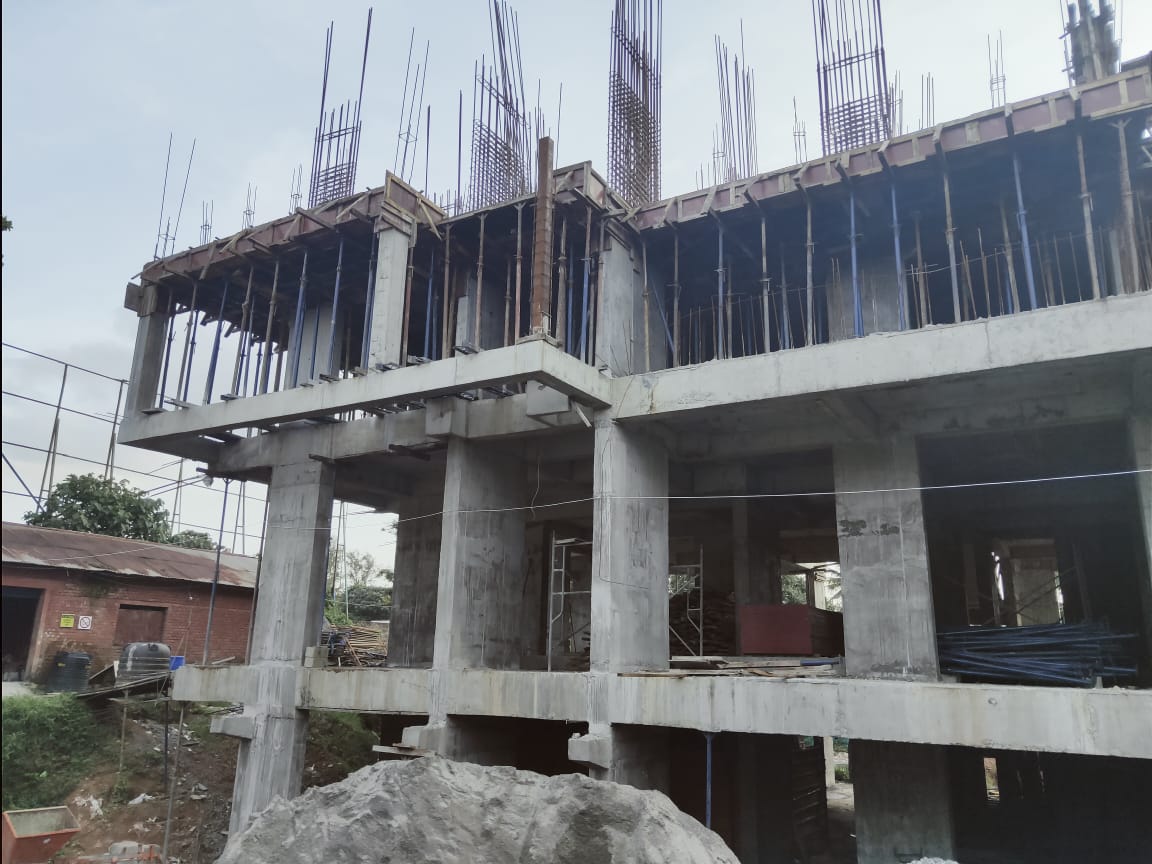

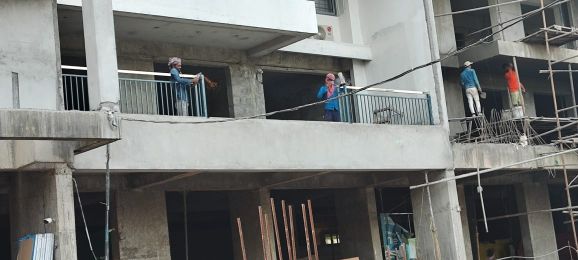

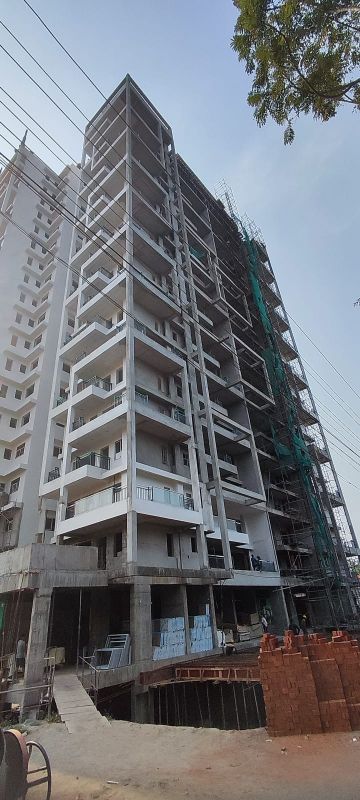

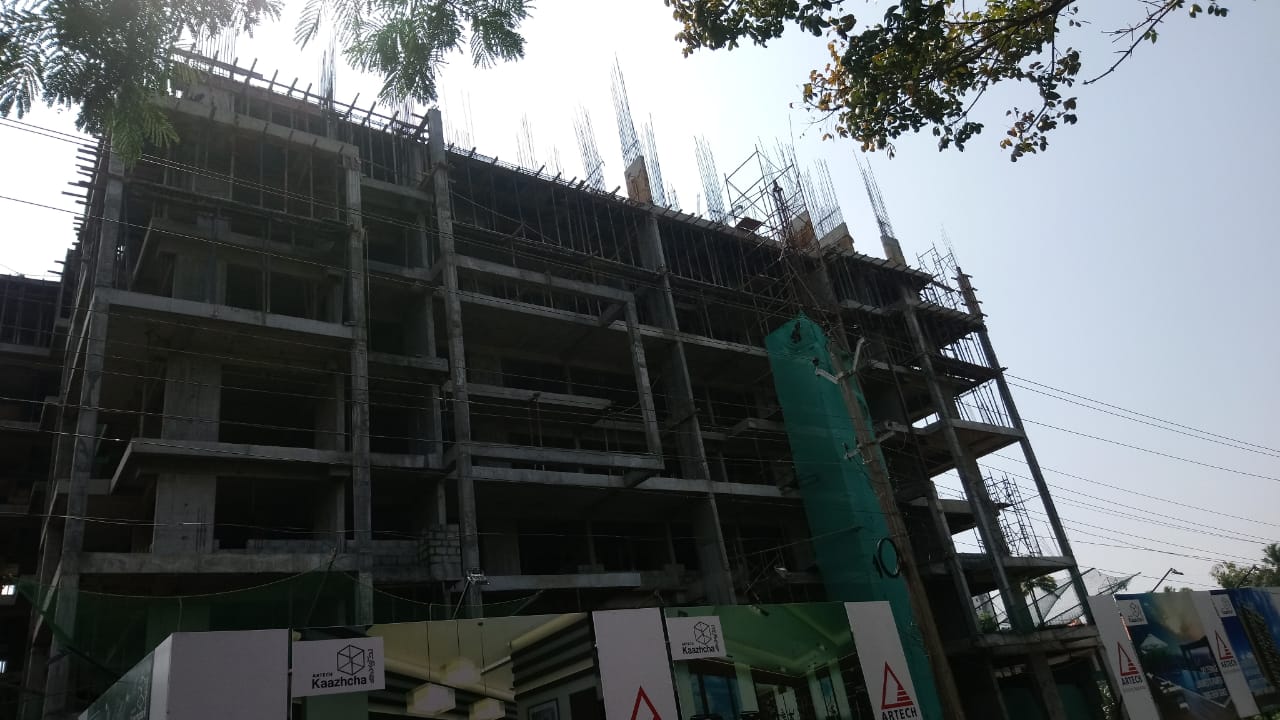

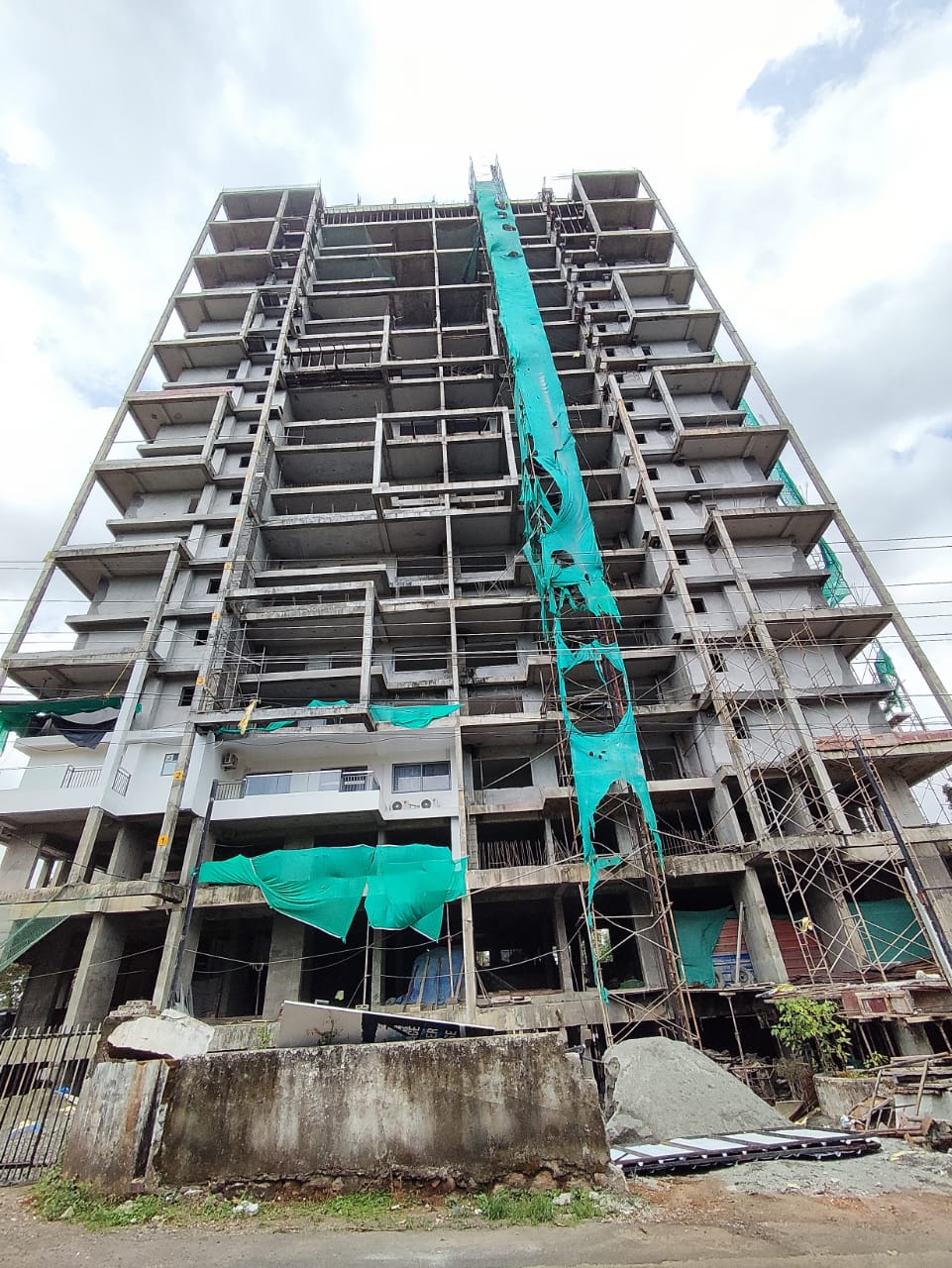

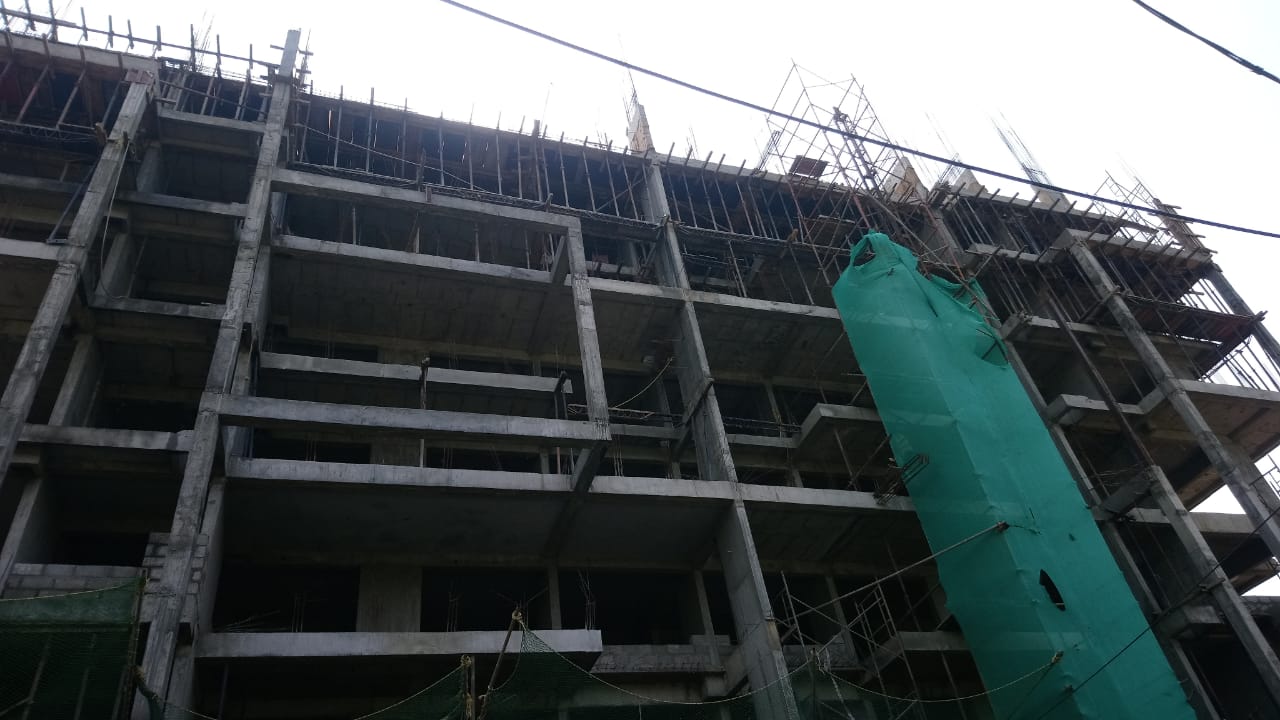

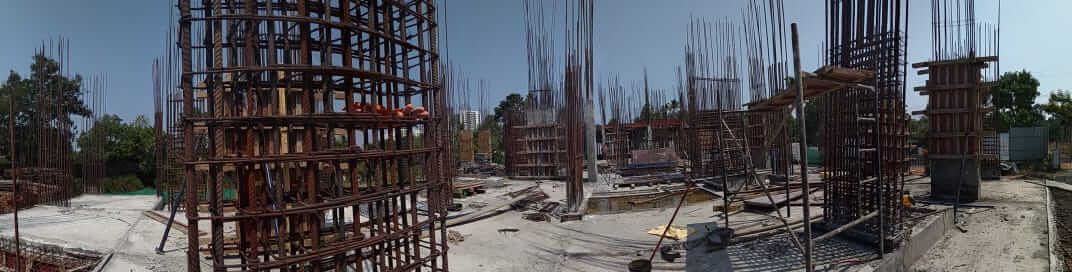

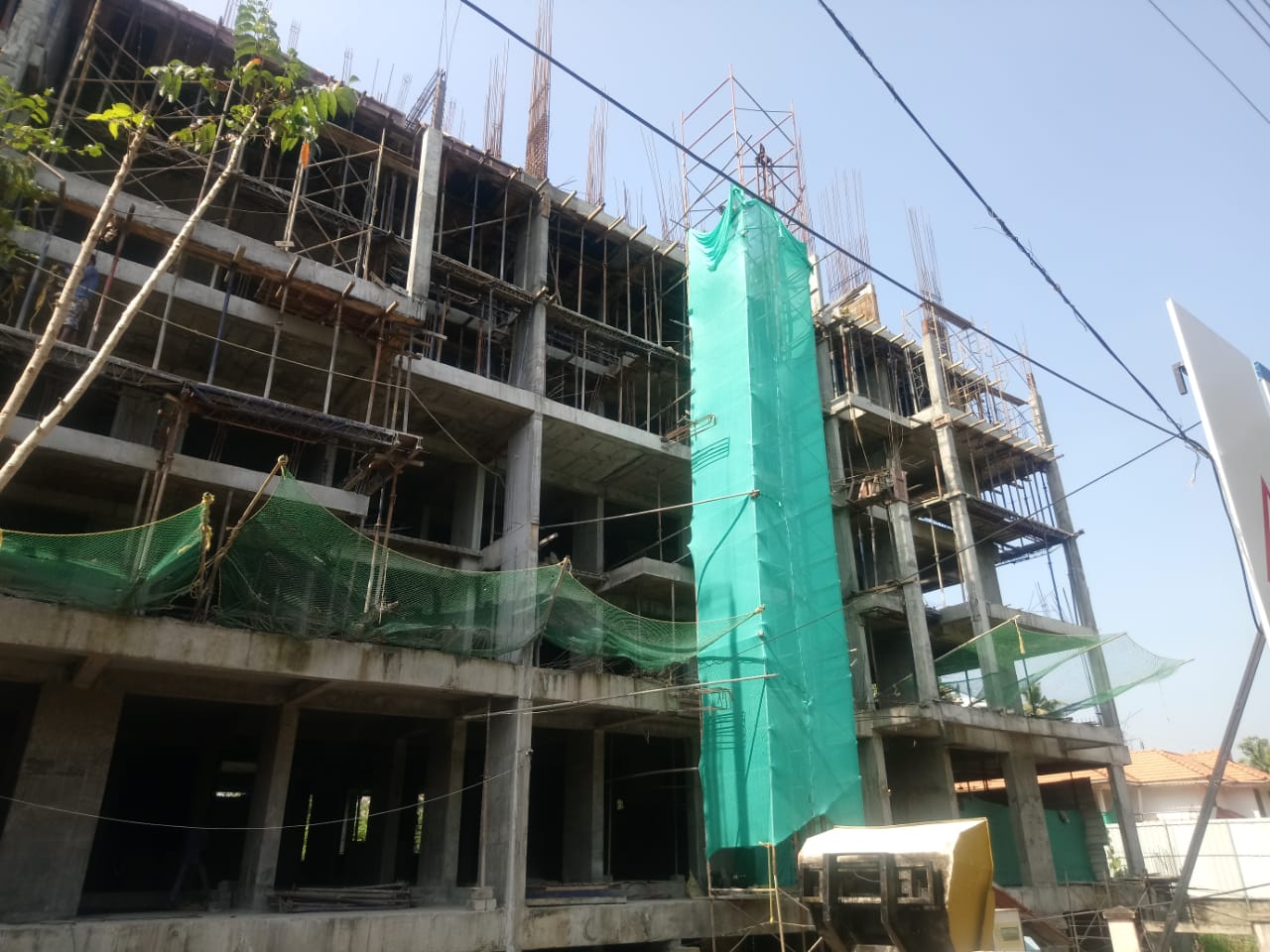

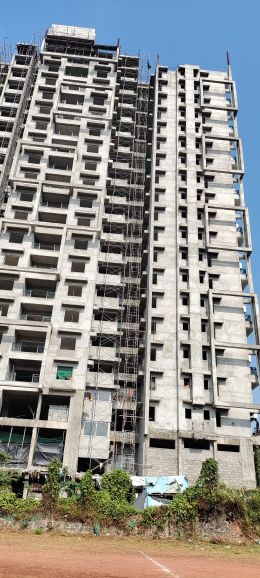

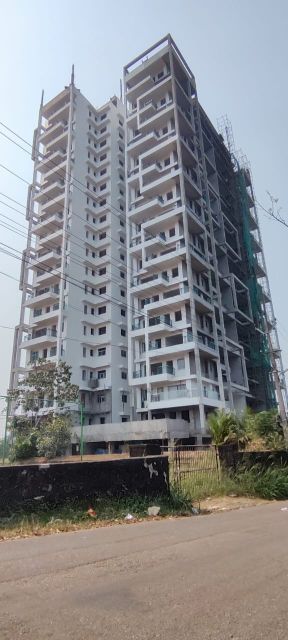

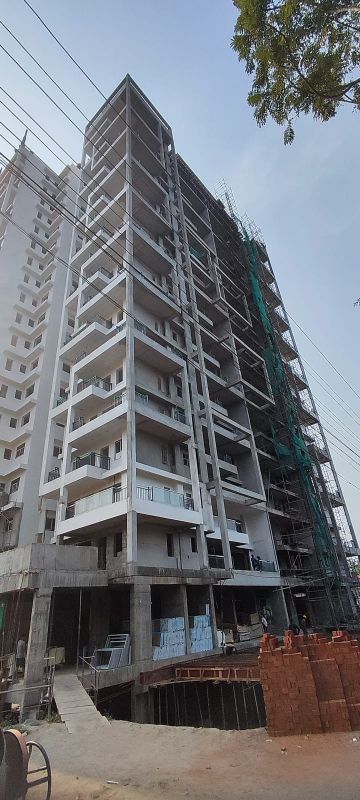

  • Column Work : GF-13th Floor -100% Completed ,BF-58% completed,14th floor-100% completed, 15th floor-50% completed.
  • Ceiling plastering work: Ground floor: Ceiling 75% completed, 1st floor-10th floor :- 100% completed
  • Blockwork: 2nd floor:- 95% completed, 3rd floor- 6th floor -95% completed,7th floor-50% completed.

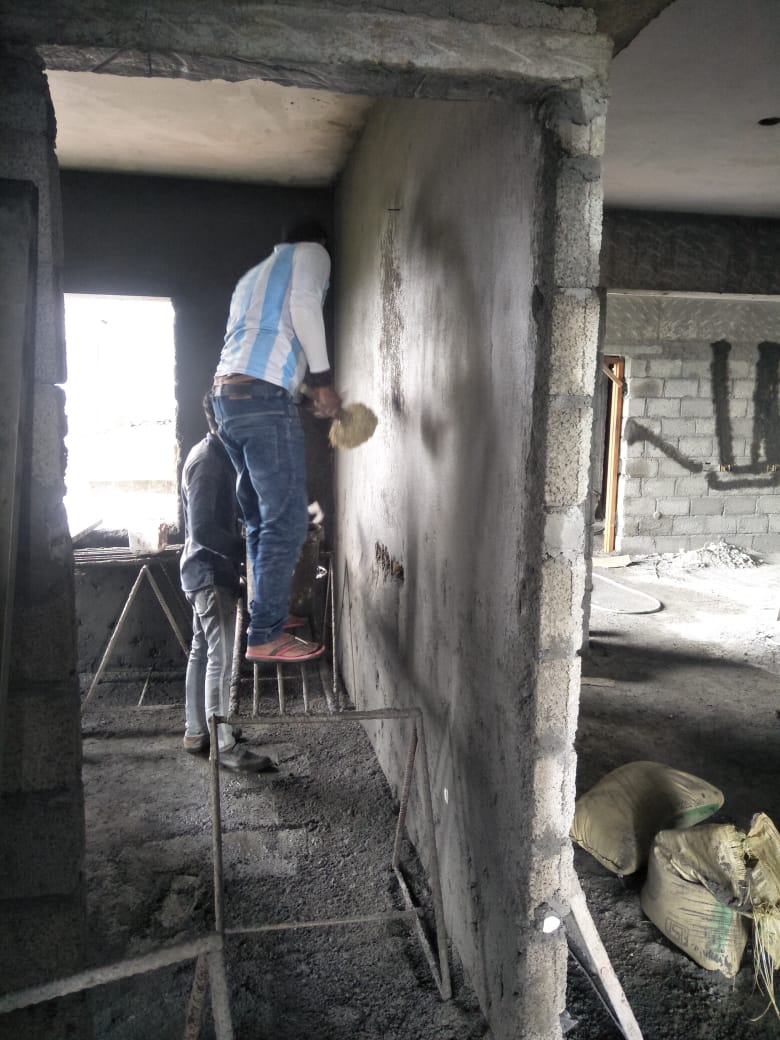

  • Wall plastering: 2nd floor:-100% completed, 3rd floor -100% completed, 4th floor-20% completed

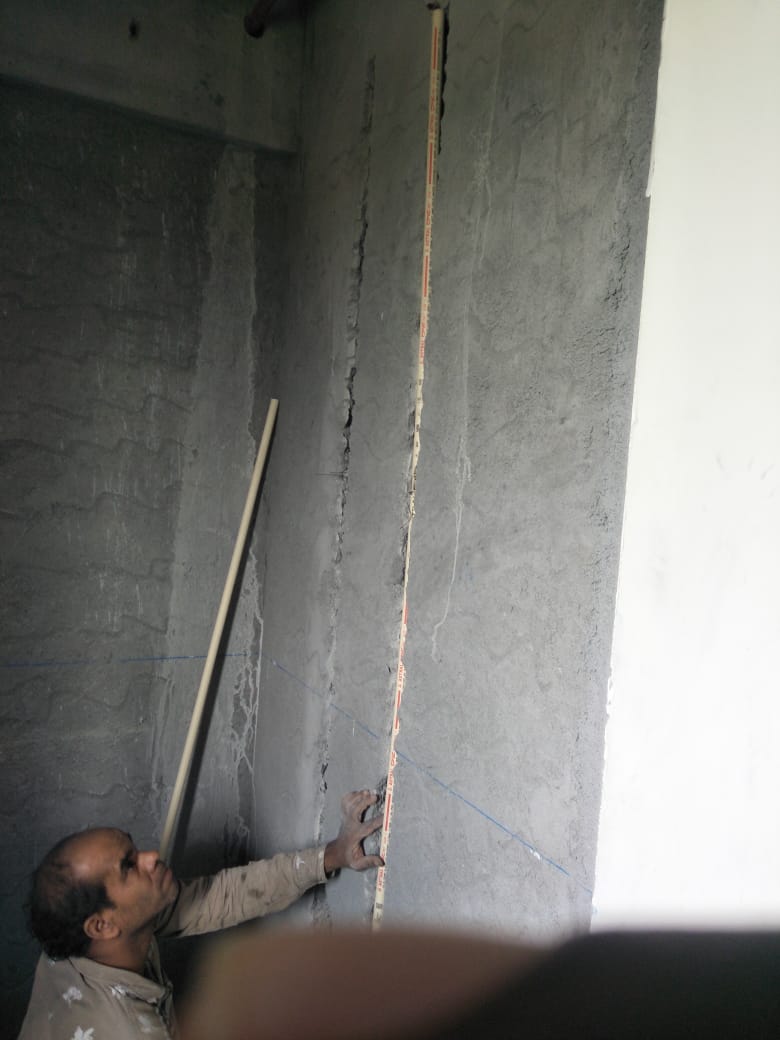

  • Putty & Primer works: 2nd floor – 20% completed

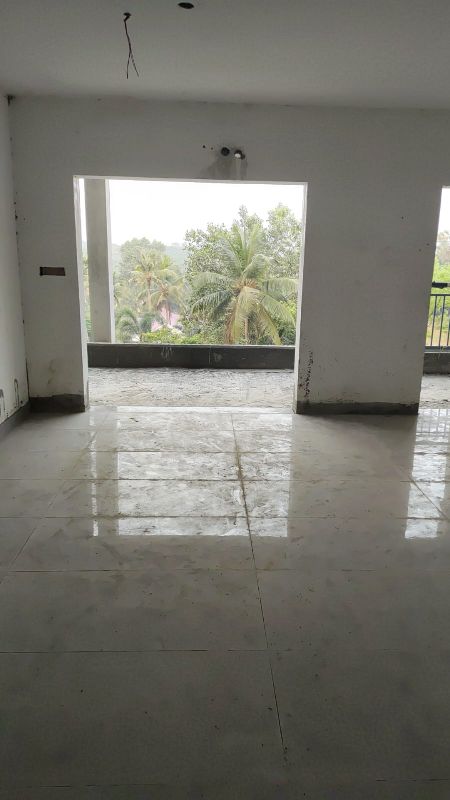

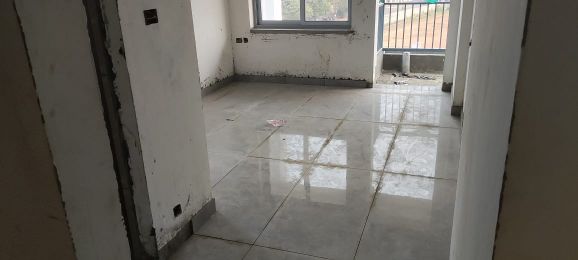

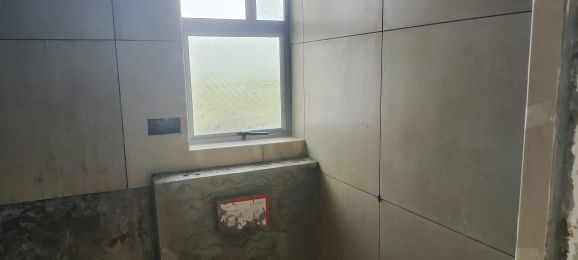

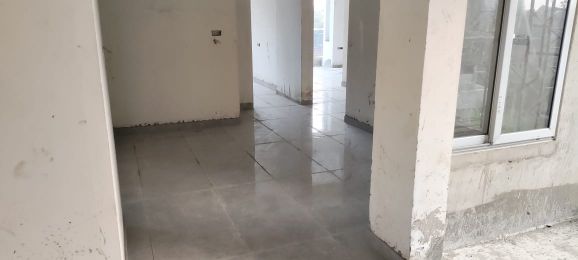

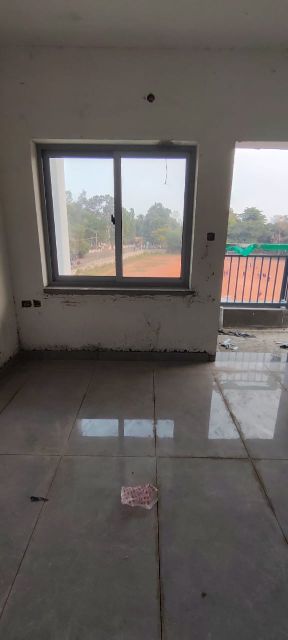

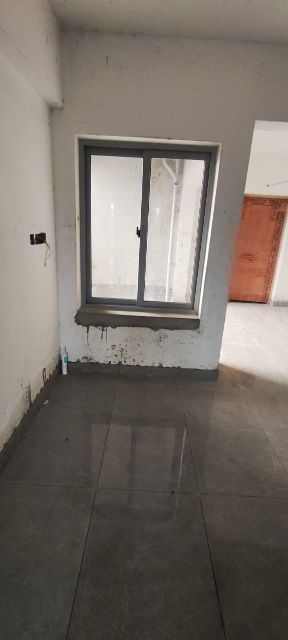

  • Tiling work :
  • Door frame fixing: 2nd floor-6th floor :-100% completed.
  • Electrical chasing: 2nd floor-3rd floor:-100% completed, 4th floor -80% completed

As per the current work status from our site, we are targeted to complete the following works by the end of MARCH 2021.

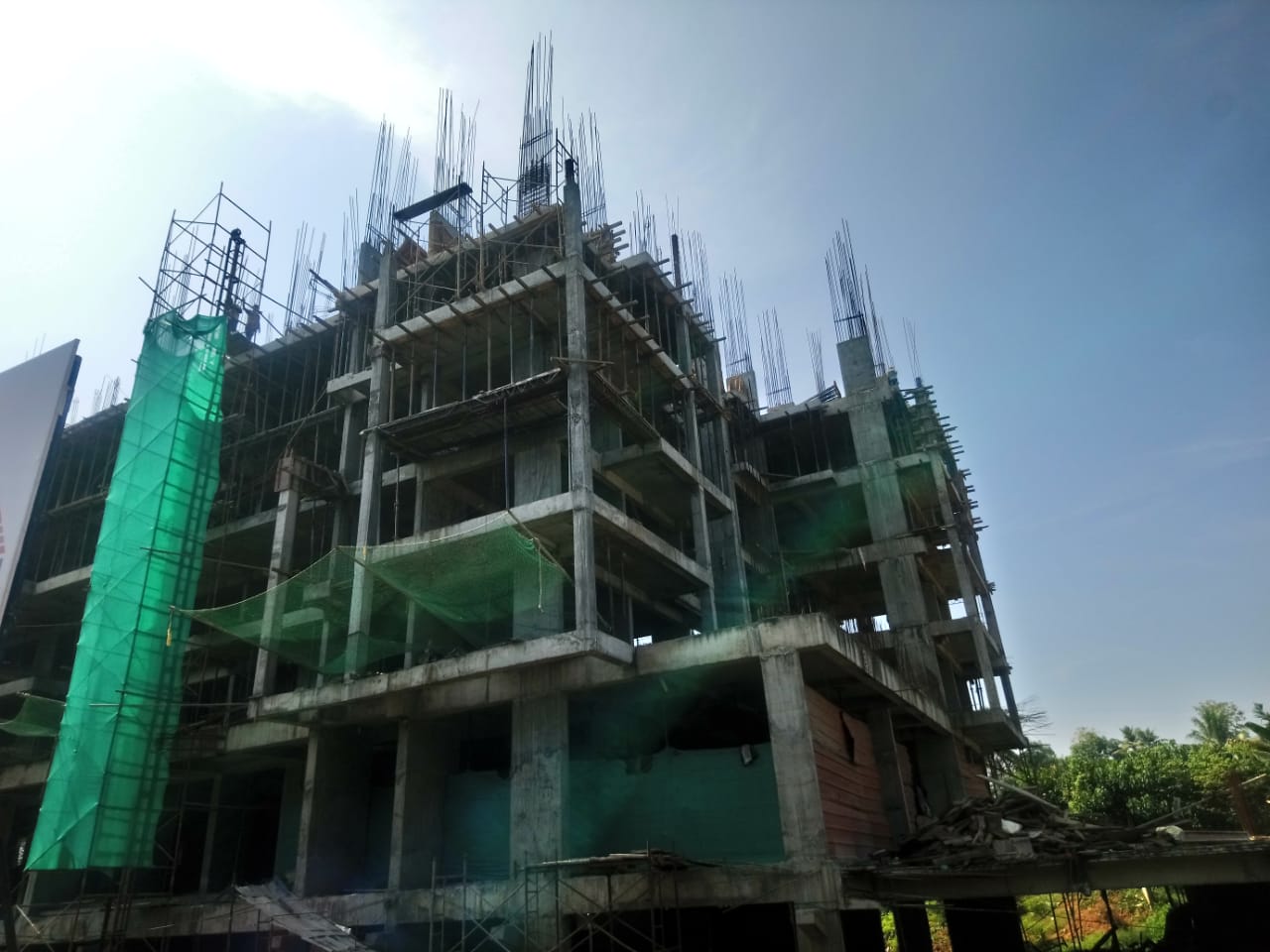

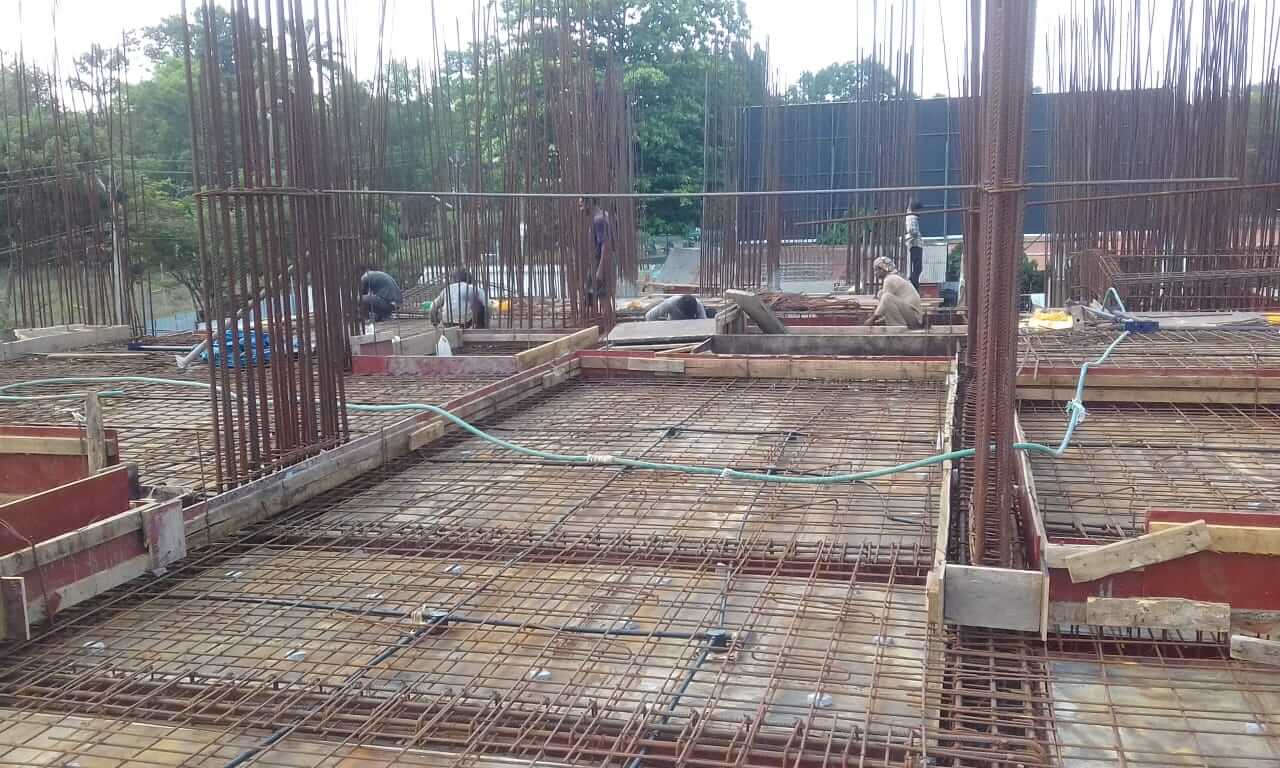

  • Beam and Slab Work: 15th-16th floor -100% to be completed

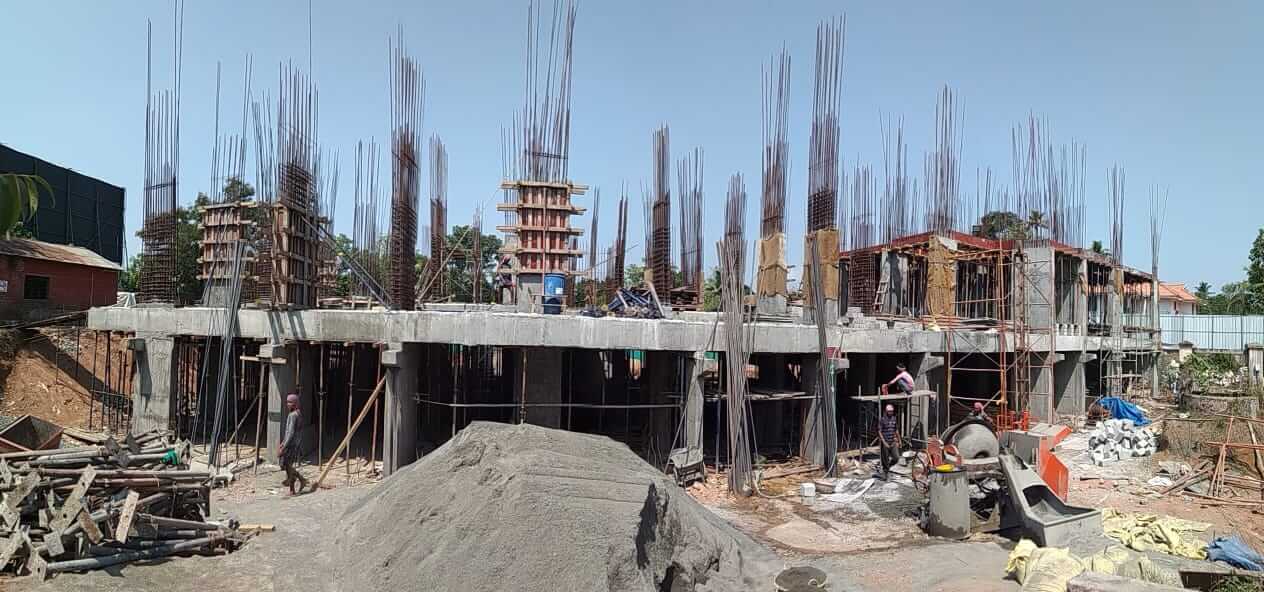

  • Column Work: 15th floor -100% to be Completed,16th floor-50%to be completed.
  • Ceiling plastering work: 11th floor: 100% to be completed
  • Blockwork: 7th floor-100 %to be completed,8th floor:- 50% to be completed
  • Wall plastering: 4th floor:-100% to be completed
  • Putty & Primer works

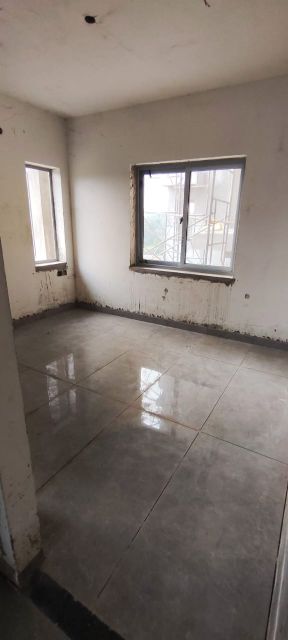

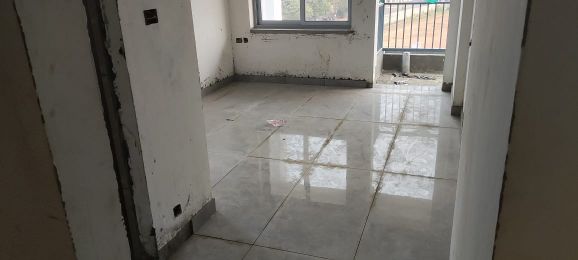

  • Tiling work: sample flat:- 50% to be completed
  • Door frame fixing
  • Electrical chasing: 5th floor -100% to be completed

As per the current work status from our site we are targeted to complete the following works by end of February 2021

  • Beam and Slab Work: 15th floor -100% to be completed
  • Column Work: 14th floor -100% to be Completed
  • Ceiling plastering work: 11th floor: 100% to be completed
  • Blockwork: 6th-7th floor:- 100% to be completed
  • Wall plastering: 3rd floor:-100% to be completed

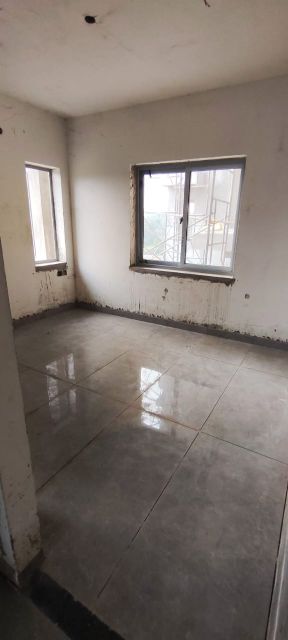

  • Tiling work: sample flat:- 50% to be completed
  • Electrical chasing: 4th floor -100% to be completed

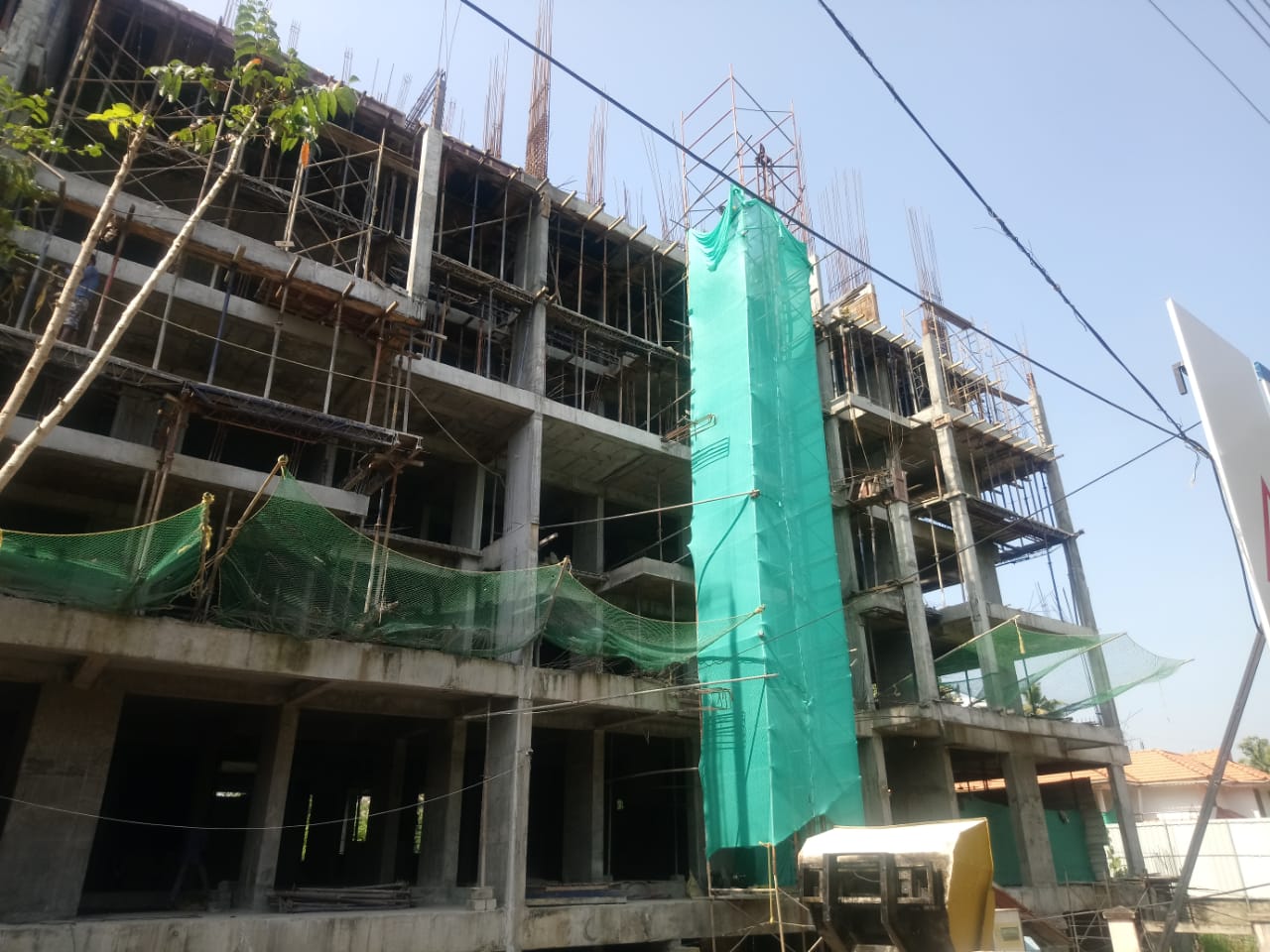

Work status as on 09.02.2021, we have completed the following

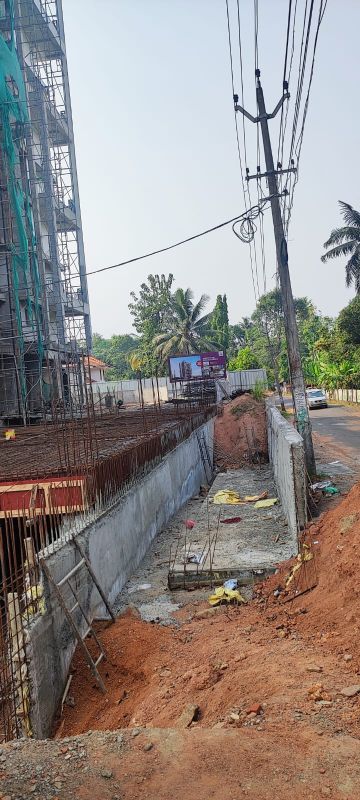

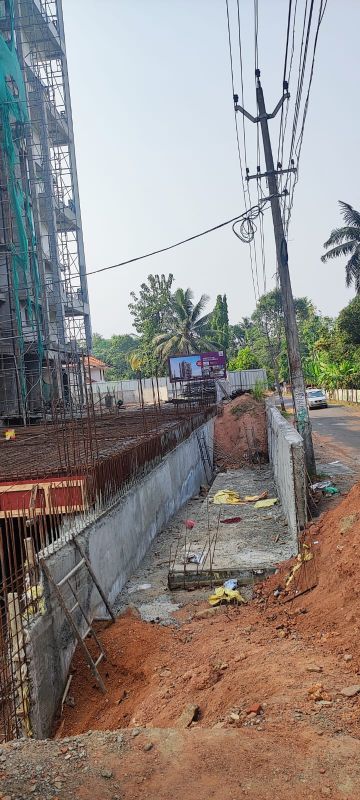

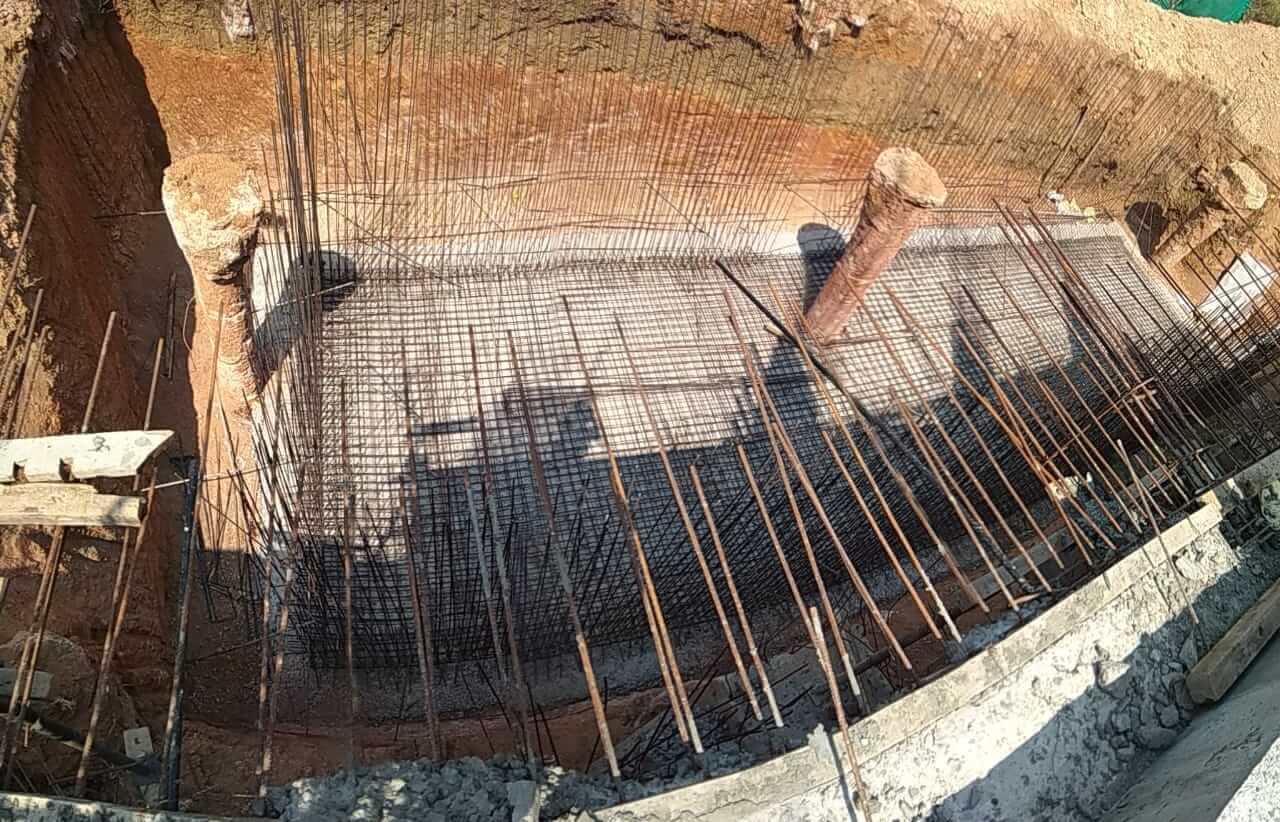

  • Earth work excavation for piling :89% completed
  • Pile cap RCC work – 84% completed

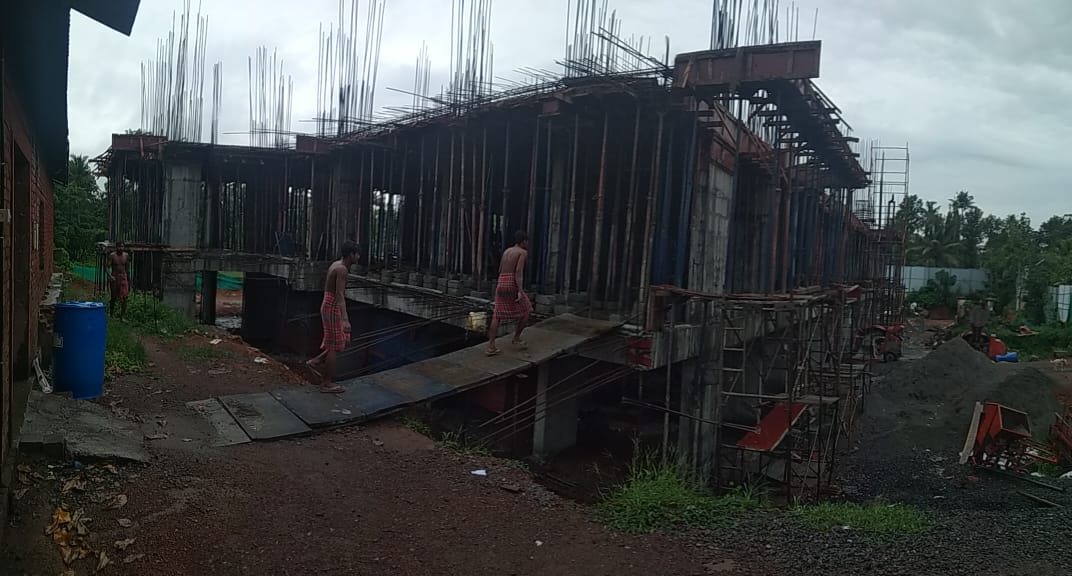

  • Beam and Slab Work : Basement floor -14th floor:100% completed
  • Column Work : GF-13th Floor -100% Completed ,BF-58% completed,14th floor-50% completed.
  • Ceiling Plastering:
  1. Ground floor :Ceiling 75% completed
  2. 1st floor-10th floor :- 100% completed

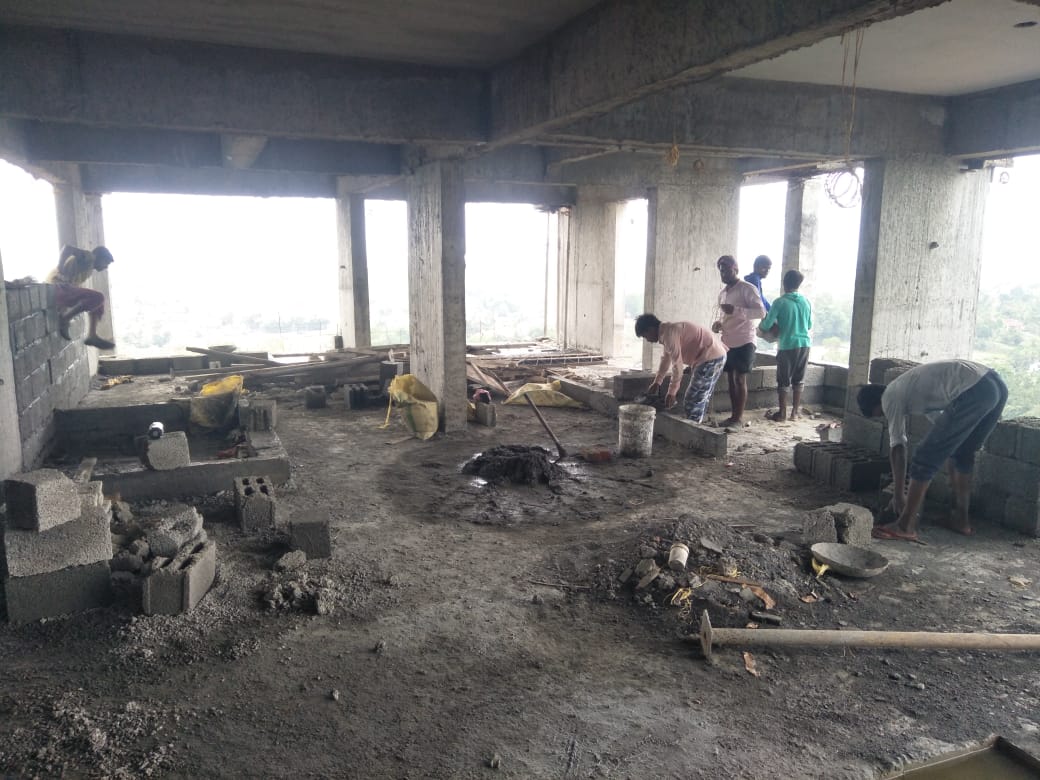

  • Blockwork: 2nd floor:- 95% completed, 3rd floor- 6th floor -90% completed,7th floor-10% completed.

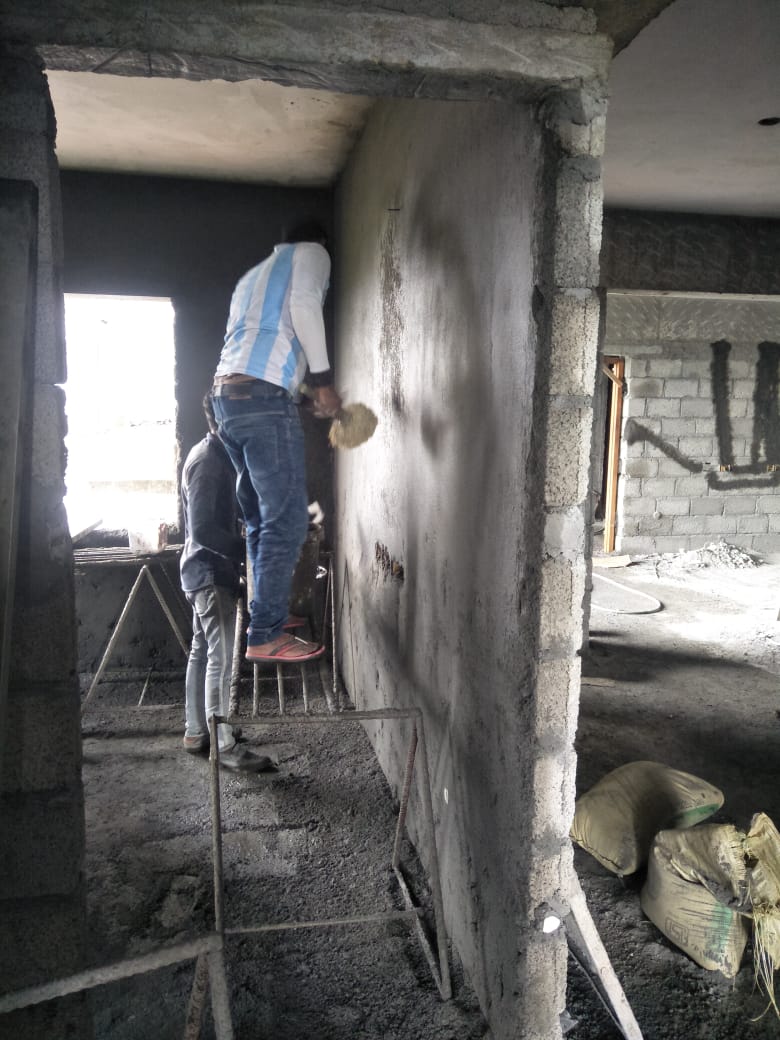

  • Wall plastering: 2nd floor :-100% completed, 3rd floor -25% completed
  • Putty & Primer works: 2nd floor – 20% completed
  • Door frame fixing: 2nd floor-4th floor :-100% completed.
  • Electrical chasing: 2nd floor-3rd floor:-100% completed, 4th floor -25% completed

As per the current work status from our site we are targeted to complete the following works by end of March 2020

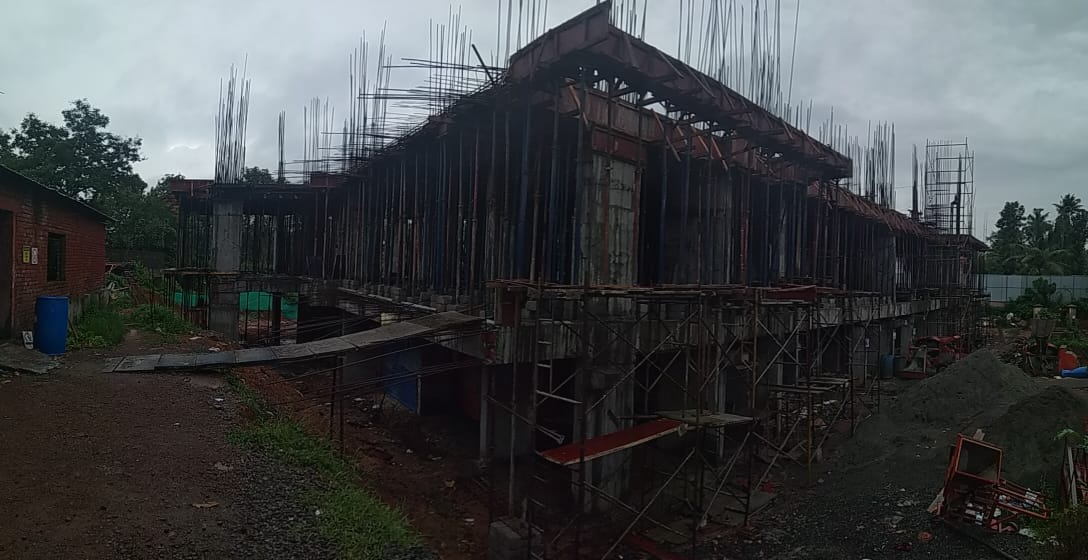

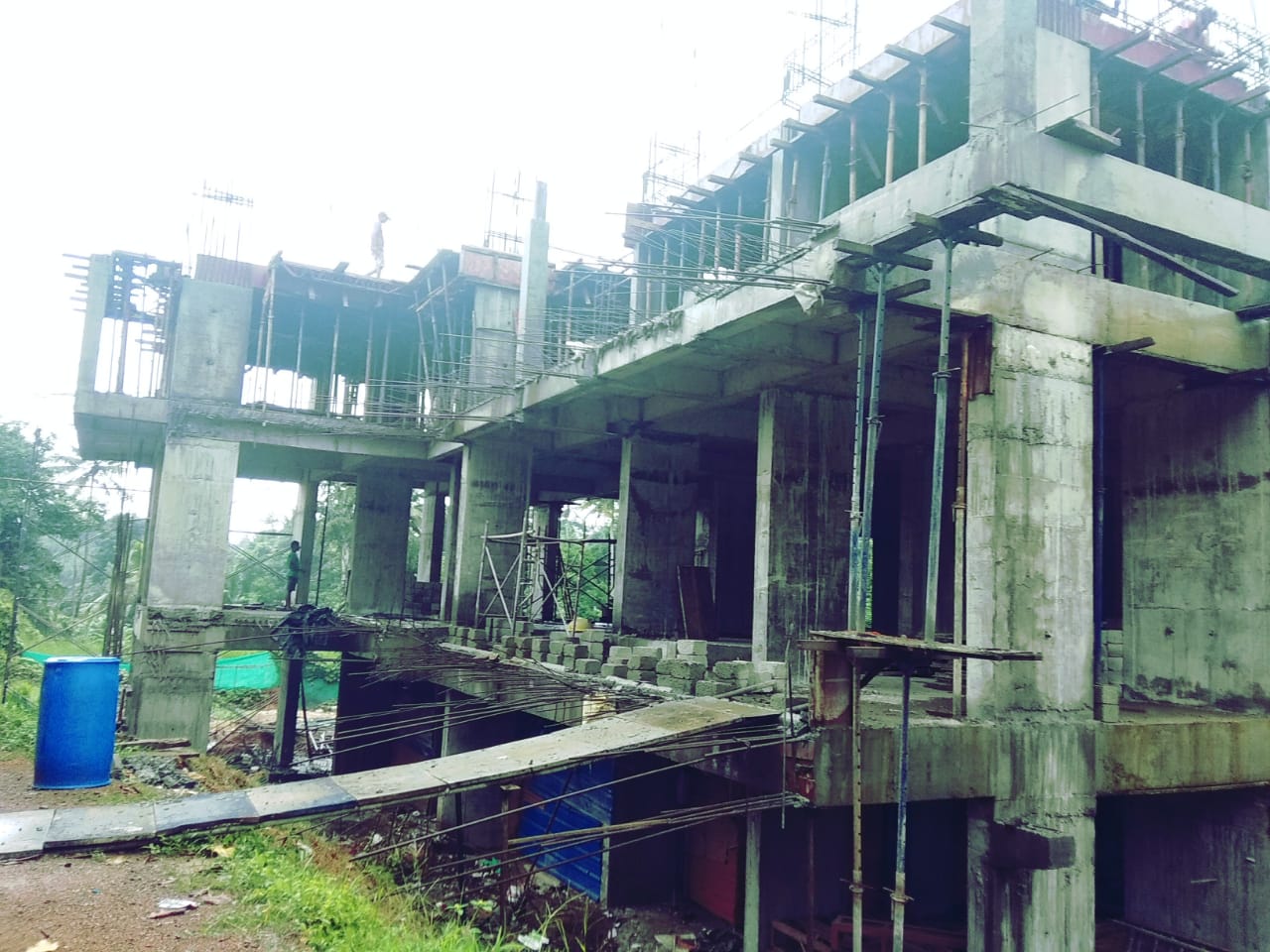

  • RCC BEAM & SLAB -Seventh floor:100% to be completed, eight floor :-100% to be completed.

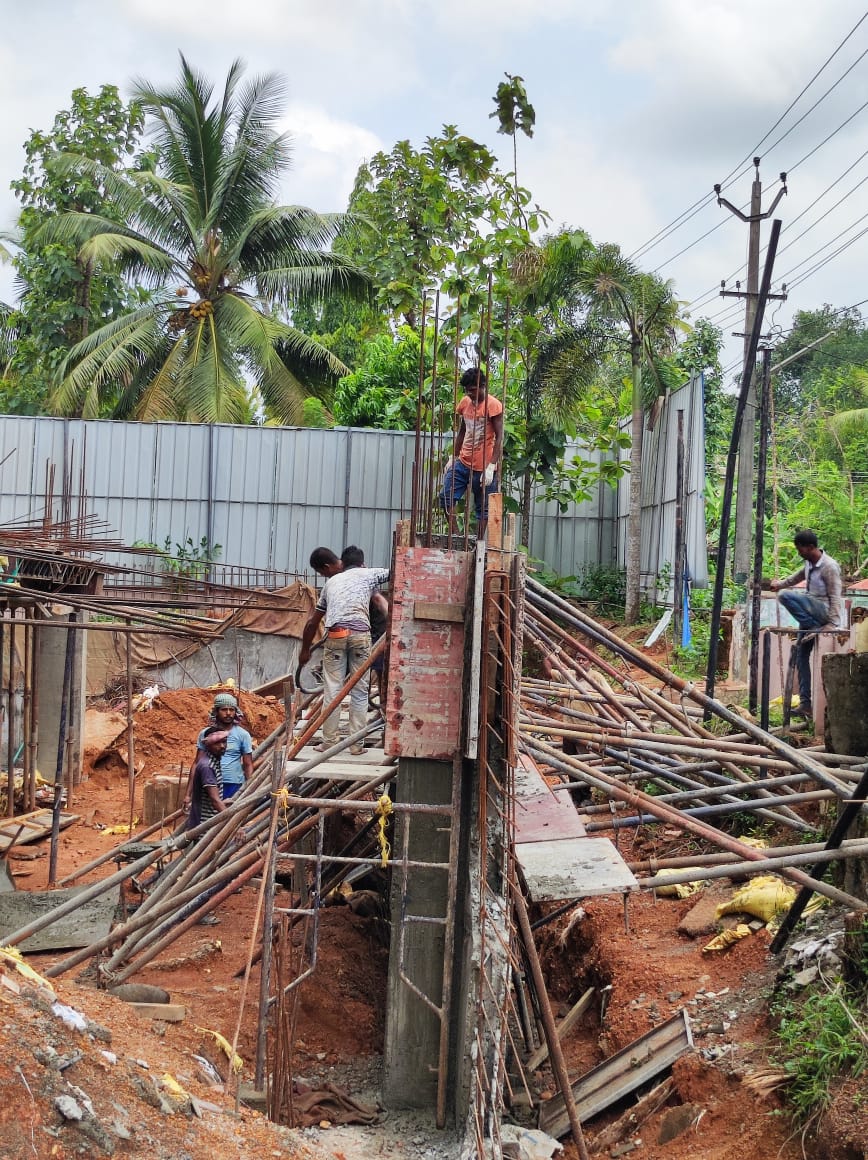

  • Column Work: 7th floor :- 100% to be completed, 8th floor -50% to be Completed.
  • Ceiling plastering:
  1. Ground floor :Ceiling 100% to be completed
  2. First floor : Ceiling 100% to be completed
  3. Second floor : Ceiling 100% to be completed
  • Blockwork: Second floor:-100% to be completed
  • Wall plastering: Second floor :sample flat (b)-100% to be completed

Work status as on 11.03.2020, we have completed the following

  • Earth work excavation for piling :89% completed
  • Pile cap RCC work – 84% completed
  • Pile chipping work – 100% completed
  • Floor Slab Work :
  1. Basement floor :100% completed
  2. Ground floor -4th floor:100% completed
  3. Fifth floor:100% completed
  4. sixth floor ;100% completed
  5. seventh floor ;50% completed
  • Column RCC Work:
  1. GF-5F -100% Completed
  2. 6th floor -100% Completed.
  • Ceiling Plastering:
  1. Ground floor :Ceiling 75% completed
  2. first floor :- 90% completed
  3. second floor :- 20% completed
  • Blockwork: Second floor:-15% completed

As per the current work status from our site we are targeted to complete the following works by end of February 2020

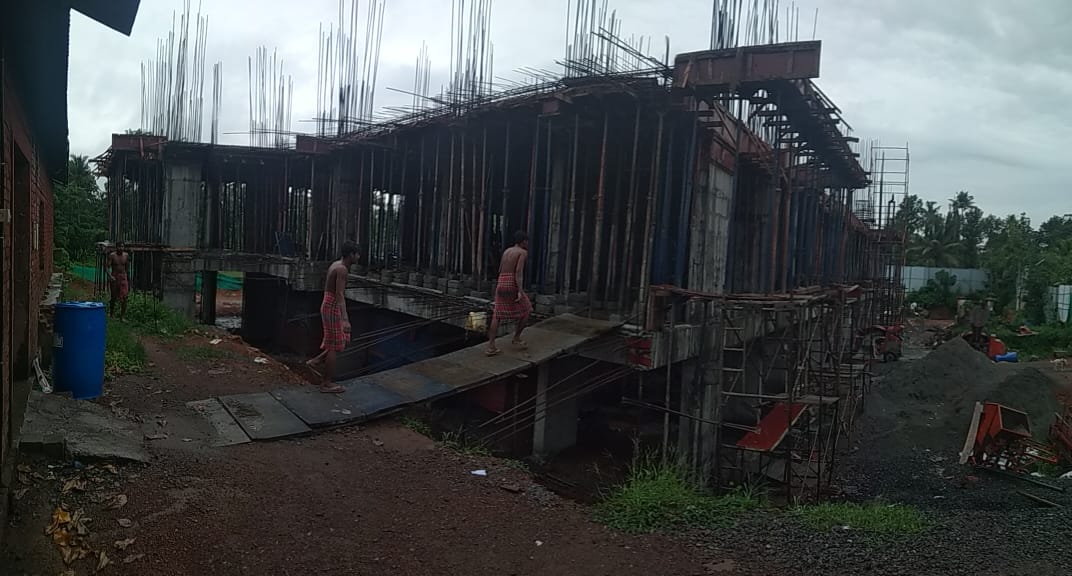

  • RCC BEAM & SLAB -Sixth floor:100% to be completed , Seventh floor:100% to be completed.
  • 6th floor :- 100% to be completed, 7th floor -50% to be Completed.
  • Ceiling plastering:
  1. Ground floor :Ceiling 100% to be completed
  2. First floor : Ceiling 100% to be completed
  3. Second floor : Ceiling 100% to be completed
  • Blockwork: Second floor-sample flat (b)-100% to be completed
  • Wall plastering: Second floor-sample flat (b)-100% to be completed

Work status as on 08.02.2020, we have completed the following

  • Earth work excavation for piling :89% completed
  • Pile cap RCC work – 84% completed
  • Pile chipping work – 100% completed
  • Floor Slab Work :
  1. Basement floor: 100% completed
  2. Ground floor -4th floor: 100% completed
  3. Fifth floor: 100% completed
  4. Sixth floor: 40% completed
  • Column RCC Work:
  1. GF-5F -100% Completed
  2. 5th floor :- 100% completed, 6th floor -25% Completed.
  • Ceiling Plastering:
  1. Ground floor : Ceiling 75% completed
  2. First floor : 90% completed

As per the current work status from our site we are targeted to complete the following works by end of January 2020

  • Fifth floor:100% to be completed ,Sixth floor:100% to be completed
  • 5TH-6TH-100 % to be Completed
  • Ceiling plastering:
  1. Ground floor :Ceiling 100% to be completed
  2. First floor : Ceiling 100% to be completed
  3. Second floor : Ceiling 100% to be completed

Work status as on 10.01.2020, we have completed the following

  • Piling work – 100% completed
  • Earth work excavation for piling :89% completed
  • Pile cap RCC work – 84% completed
  • Pile chipping work – 100% completed
  • Floor Slab Work :
  1. Basement floor :100% completed
  2. Ground floor -Fourth floor:100% completed
  3. Fifth floor:50% completed
  • Column RCC Work:
  1. GF-5F -100% Completed
  2. 5TH-6TH-25 %Completed
  • Ceiling plastering:
  1. Ground floor :Ceiling 75% completed
  2. First floor : Ceiling 90%completed

As per the current work status from our site we are targeted to complete the following works by end of September 2019

  • Third floor :100% to be completed

Work status as on 05.09.2019, we have completed the following

  • Piling work – 100% completed
  • Earth work excavation for piling :89% completed
  • Pile cap RCC work – 84% completed
  • Pile chipping work – 100% completed
  • Floor Slab Work: Basement floor :100% completed
  • Floor Slab Work: Ground floor :100% completed
  • Floor Slab Work: First floor :100% completed
  • Floor Slab Work: Second floor :100% completed
  • Column Work: BF-GF-100% Completed
  • Column Work: GF-1F-100% Completed
  • Column Work: 1F-2F-100% Completed

As per the current work status from our site we are targeted to complete the following works by end of August 2019

  • Second floor :100% to be completed

Work status as on 05.08.2019, we have completed the following

  • Piling work – 100% completed
  • Earth work excavation for piling :89% completed
  • Pile cap RCC work – 84% completed
  • Pile chipping work – 100% completed
  • Floor Slab Work: Basement floor :100% completed
  • Floor Slab Work: Ground floor :100% completed
  • Floor Slab Work: First floor :100% completed
  • Floor Slab Work: Second floor :40% completed
  • Column Work: BF-GF-100% Completed
  • Column Work: GF-1F-100% Completed
  • Column Work: 1F-2F-100% Completed

As per the current work status from our site we are targeted to complete the following works by end of July 2019

  • Second floor :100% to be completed

Work status as on 06.07.2019, we have completed the following

  • Piling work – 100% completed
  • Earth work excavation for piling :89% completed
  • Pile cap RCC work – 84% completed
  • Pile chipping work – 100% completed
  • Floor Slab Work: Basement floor :100% completed
  • Floor Slab Work: Ground floor :100% completed
  • Floor Slab Work: First floor :100% completed
  • Floor Slab Work: Second floor :25% completed
  • Column Work: BF -GF-100% Completed
  • Column Work: GF-1F-100 %Completed
  • Column Work: 1F-2F-100 %Completed

As per the current work status from our site we are targeted to complete the following works by end of June 2019

  • Ground floor roof slab -100% to be completed

Work status as on 06.06.2019, we have completed the following

  • Piling work – 100% completed
  • Earth work excavation for piing :88.75% completed
  • Pile cap RCC work – 84% completed
  • Pile chipping work – 100% completed

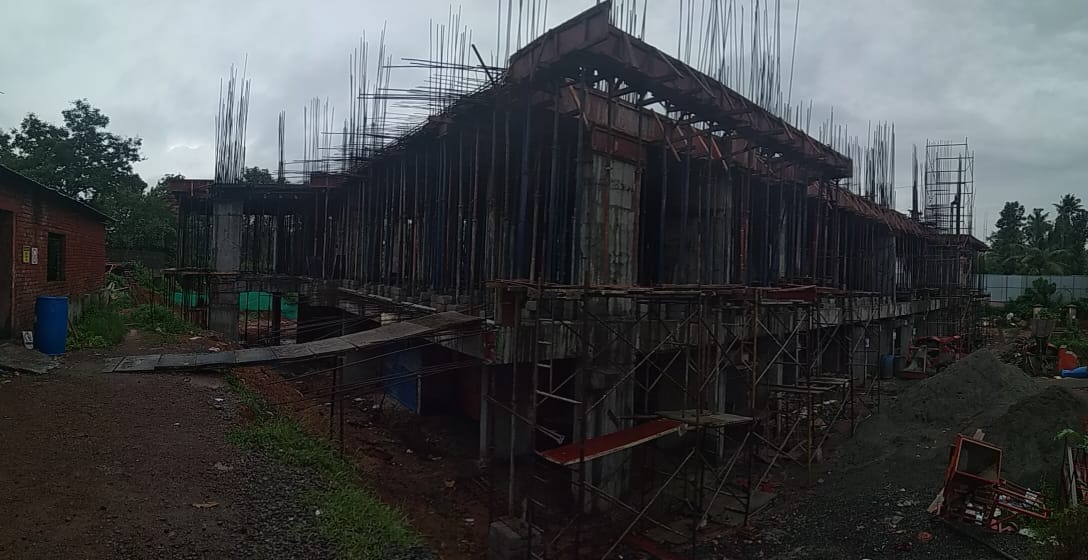

  • BF column work – 100% completed
  • BF roof slab work -100% completed
  • Ground floor Column work -100%completed
  • Ground floor roof slab -50% completed
  • STP work- Excavation completed ,PCC completed ,steel and shuttering work on progress

As per the current work status from our site we are targeted to complete the following works by end of May 2019

  • Ground floor Column work -100% to be completed
  • Ground floor roof slab -60% to be completed

Work status as on 06.05.2019, we have completed the following

  • Piling work – 100% completed
  • Earth work excavation for piing :88.75% completed
  • Pile cap RCC work – 84% completed
  • Pile chipping work – 100% completed

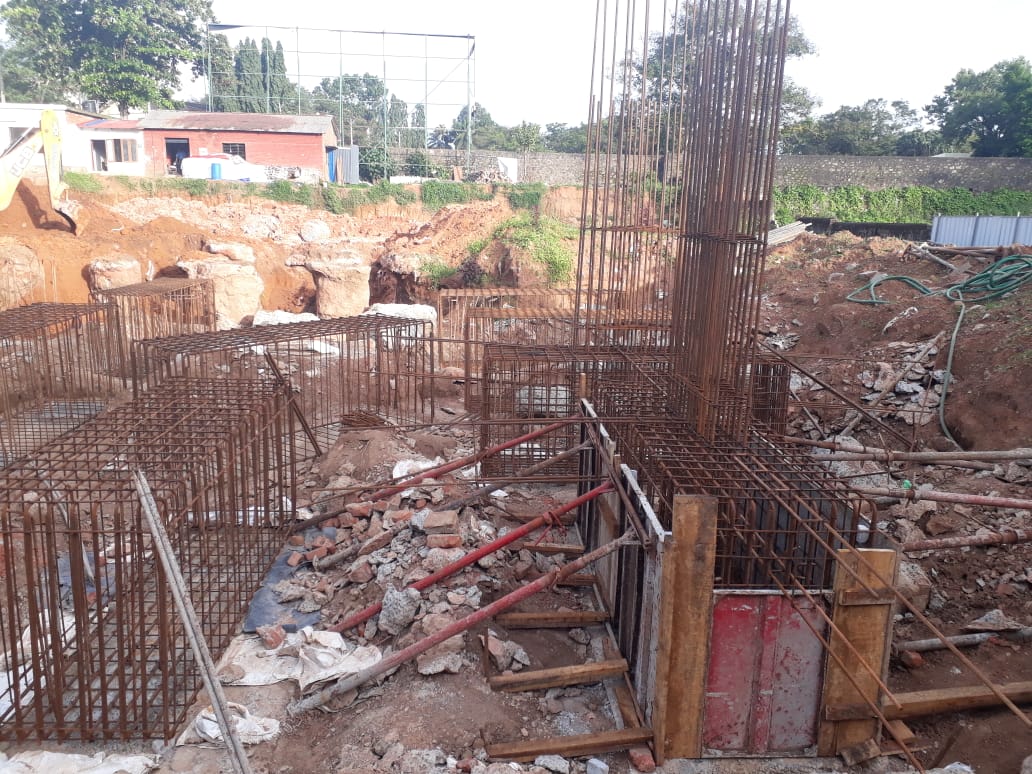

  • BF column work – 58% completed

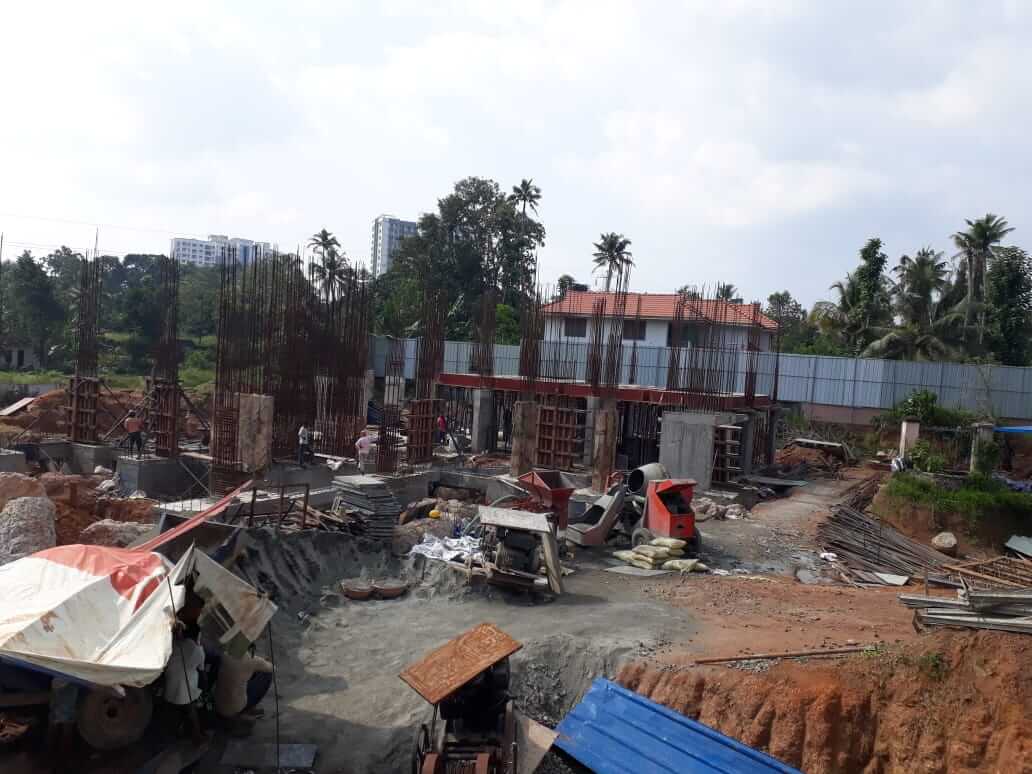

  • Grade slab work -100% completed
  • BF roof slab work -60% completed
  • Ground floor Column work -80%completed
  • Ground floor roof slab -40% completed
  • STP work- Excavation completed ,PCC completed ,steel and shuttering work on progress

As per the current work status from our site we are targeted to complete the following works by end of April 2019

  • Ground floor roof slab – 100% to be completed(1&2 phase)

Work status as on 05.04.2019, we have completed the following

  • Piling work – 100% completed
  • Pile cap RCC work – 67nos completed (out of 113)
  • Pile chipping work – 100% completed
  • BF column work – 69nos completed (out of 119)
  • Grade slab work -100% completed
  • BF roof slab work -100% completed
  • Ground floor Column work -100%completed
  • Ground floor roof slab -shuttering on progress (1 st phase )
  • STP work- Excavation completed ,PCC completed ,steel and shuttering work on progress

As per the current work status from our site we are targeted to complete the following works by end of March 2019

  • BF column work – 69 nos to be completed (out of 119)
  • BF roof slab work – 100% to be completed
  • Ground floor Column work -10% to be completed

Work status as on 06-03-2019, we have completed the following

  • Piling work – 100% completed
  • Pile cap RCC work – 67nos completed (out of 113)
  • Pile chipping work – 100% completed
  • BF column work – 65nos completed (out of 119)
  • Grade slab work -100% completed
  • BF roof slab work – 70% completed,balance portion shuttering in progress
  • Ground floor Column work -5% completed
  • STP Excavation completed

As per the current work status from our site we are targeted to complete the following works by end of February 2019

  • Pile cap work – 71nos to be completed
  • Pile chipping work – 100% to be completed
  • BF column work – 70nos to be completed (out of 119)
  • Grade slab work – 100% to be completed
  • BF roof slab work – 60% to be completed

Work status as on 05-02-2019, we have completed the following

  • Piling work – 100% completed
  • Pile cap RCC work – 62nos completed (out of 113)
  • Pile chipping work – 90% completed
  • BF column work – 62nos completed (out of 119)
  • Grade slab work -80% completed
  • BF roof slab work – 30% completed,balance portion shuttering in progress

As per the current work status from our site we are targeted to complete the following works by end of January 2019

  • Pile cap work – 75nos to be completed
  • Pile chipping work – 100% to be completed
  • BF column work – 70nos to be completed (out of 119)
  • Grade slab work – 80% to be completed
  • BF roof slab work – 60% to be completed

Work status as on 08-01-2019, we have completed the following

  • Piling work – 100% completed
  • Pile cap RCC work – 58nos completed (out of 113)
  • Pile chipping work – 80% completed
  • BF column work – 53nos completed (out of 119)
  • Grade slab work – 60% completed
  • BF roof slab work – 30% completed

As per the current work status from our site we are targeted to complete the following works by end of December 2019

  • Pile cap work – 79nos to be completed
  • Pile chipping work – 100% to be completed
  • BF column work – 65nos to be completed (out of 119)
  • Grade slab work – 30% to be completed
  • BF roof slab work – 20% to be completed

Work status as on 06-12-2018, we have completed the following

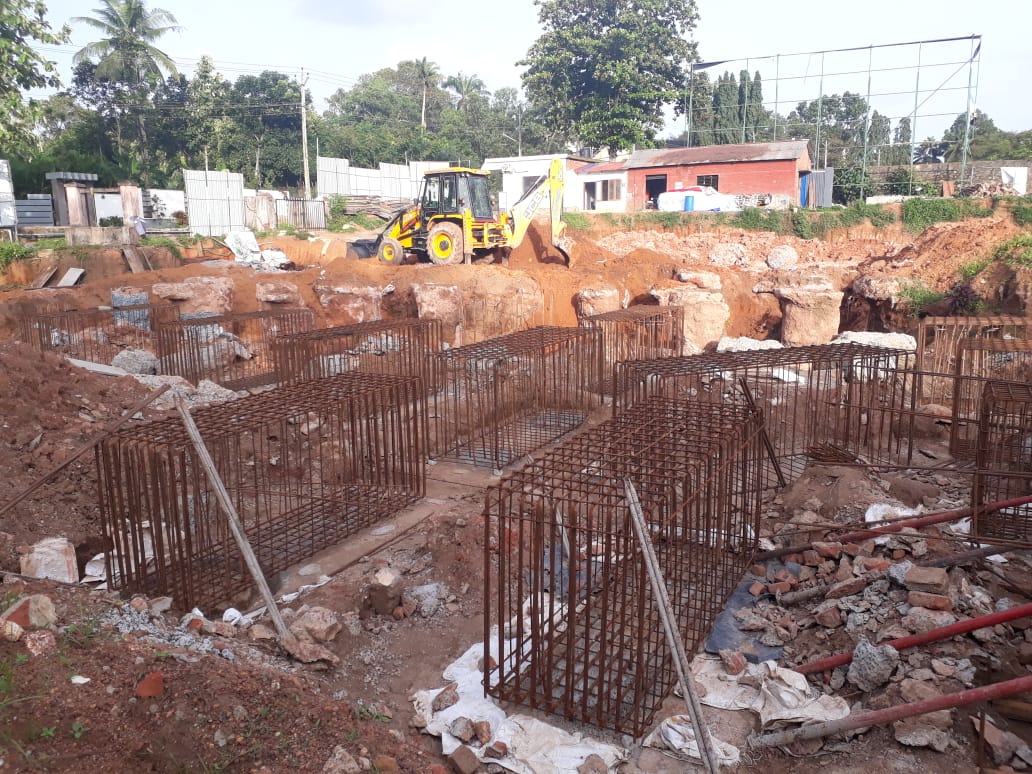

  • Piling work – 100% completed

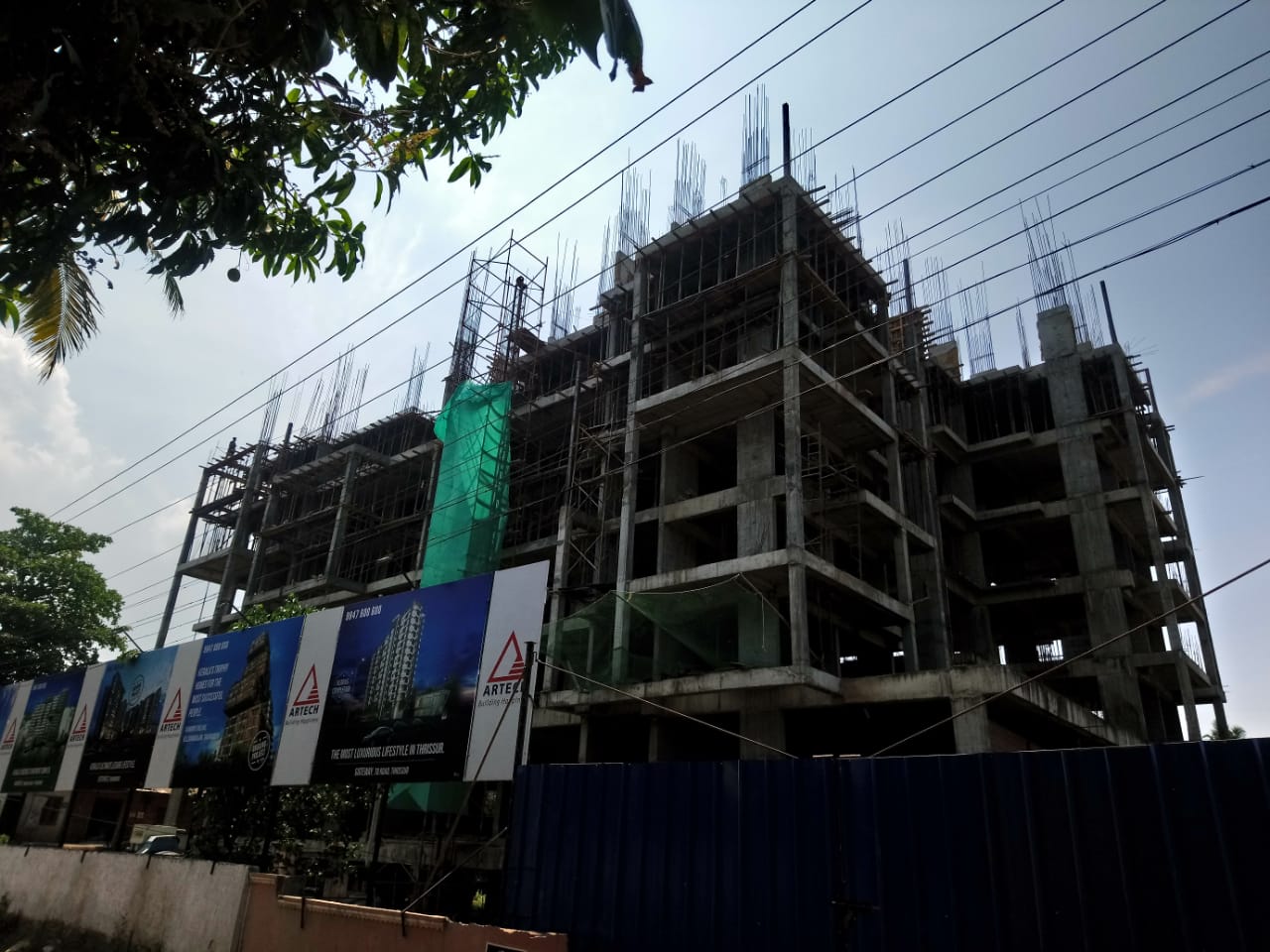

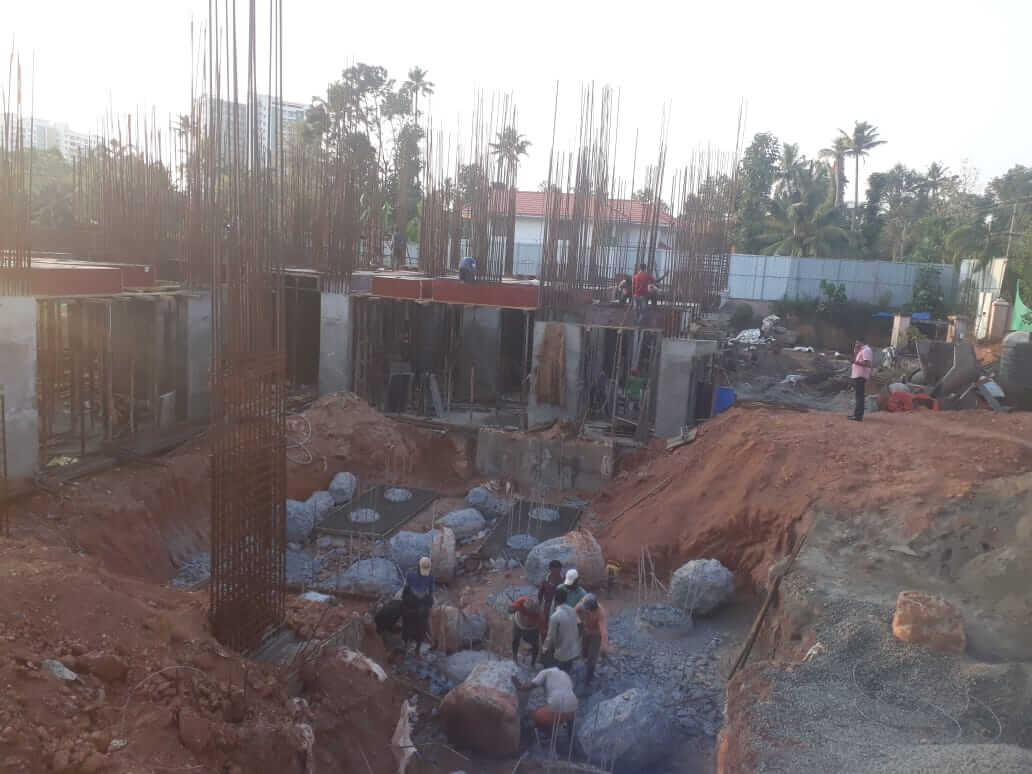

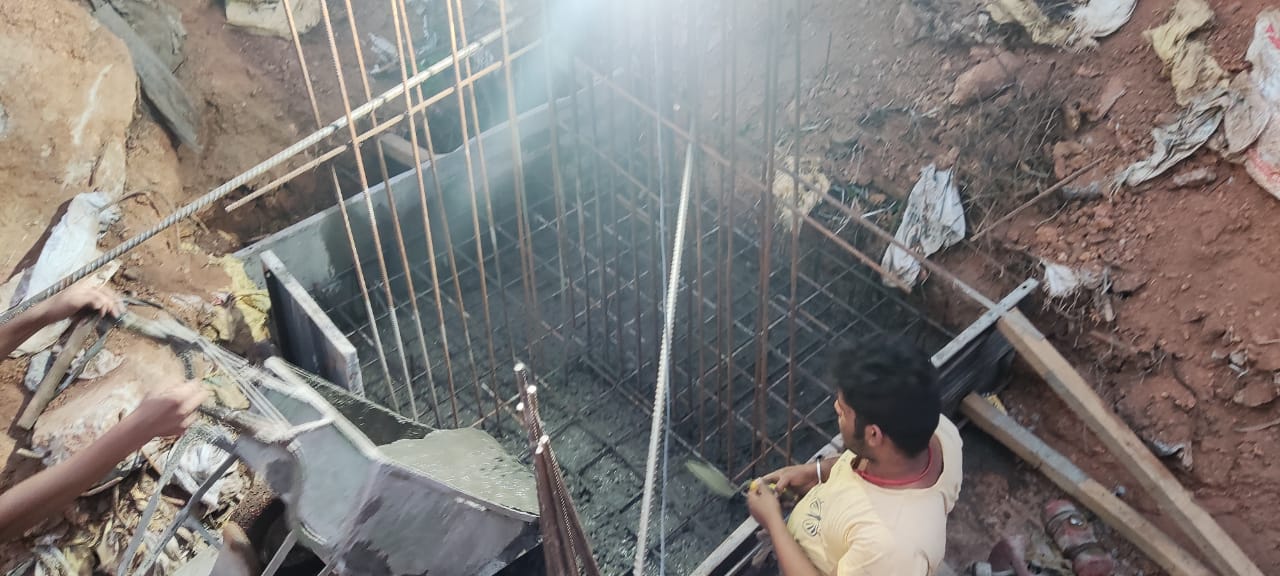

  • Pile cap RCC work – 54nos completed (out of 113)

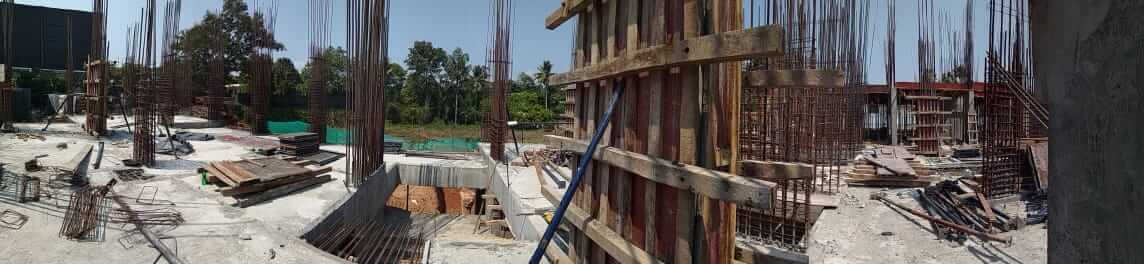

  • Pile chipping work – 80% completed

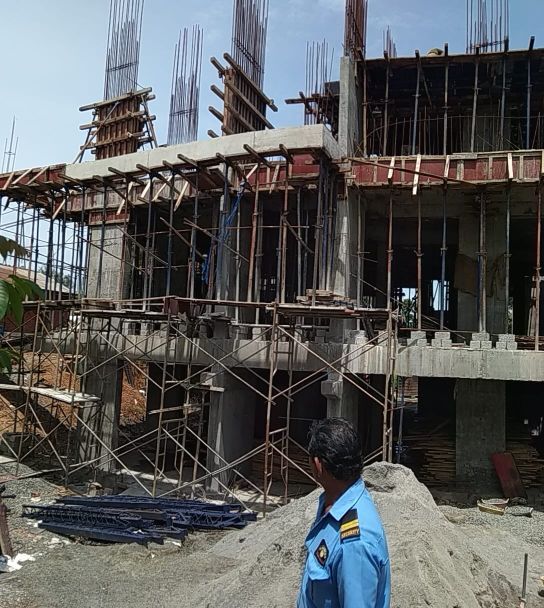

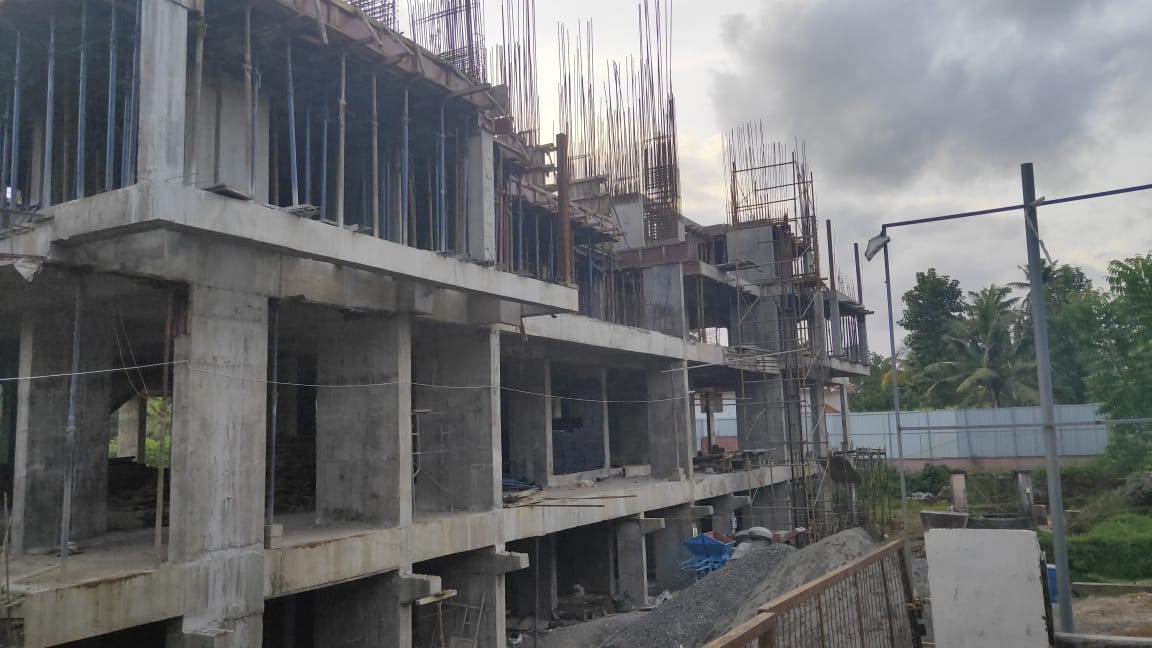

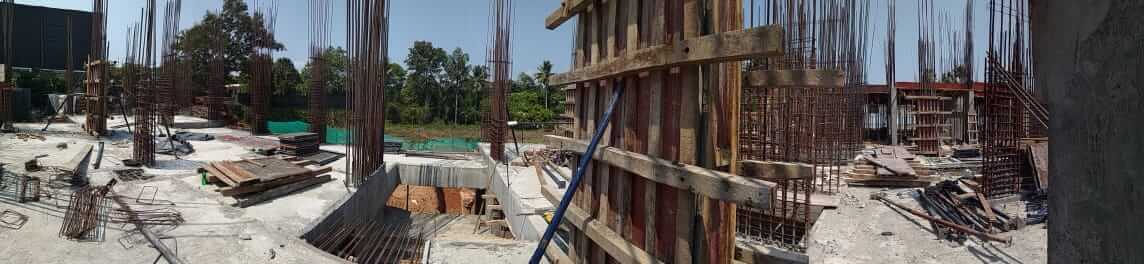

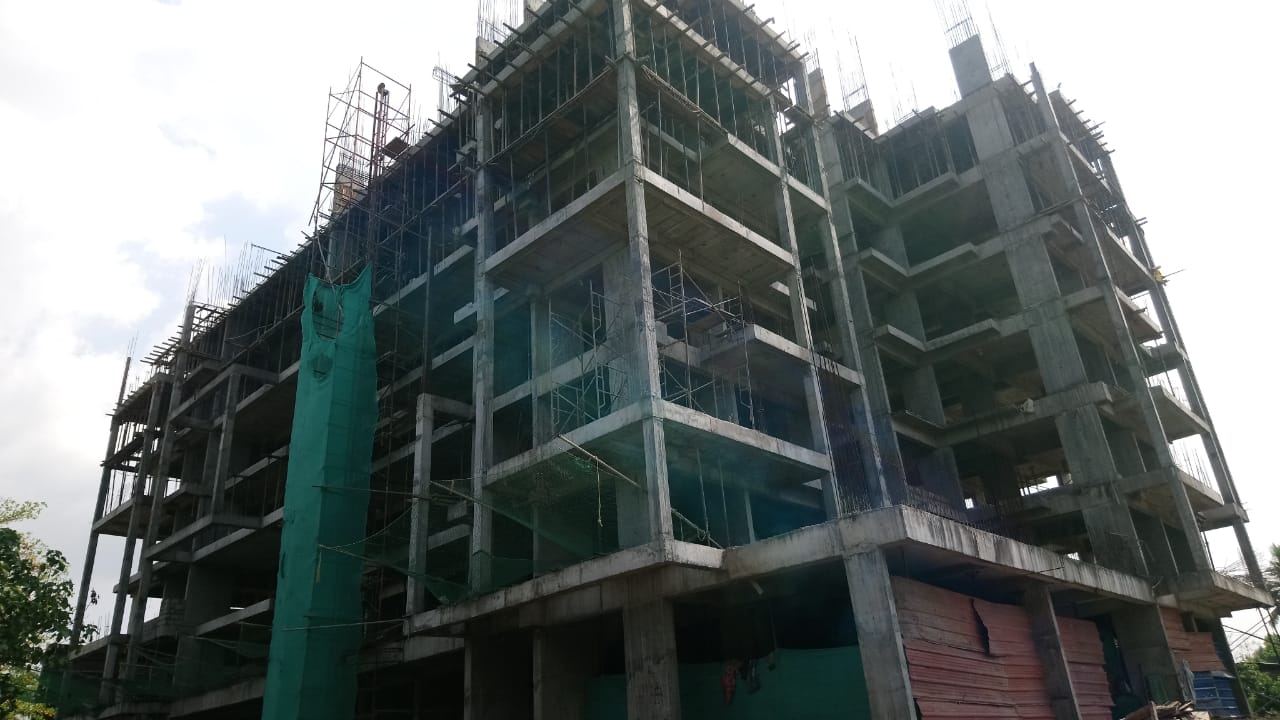

  • BF column work – 37nos completed (out of 119)

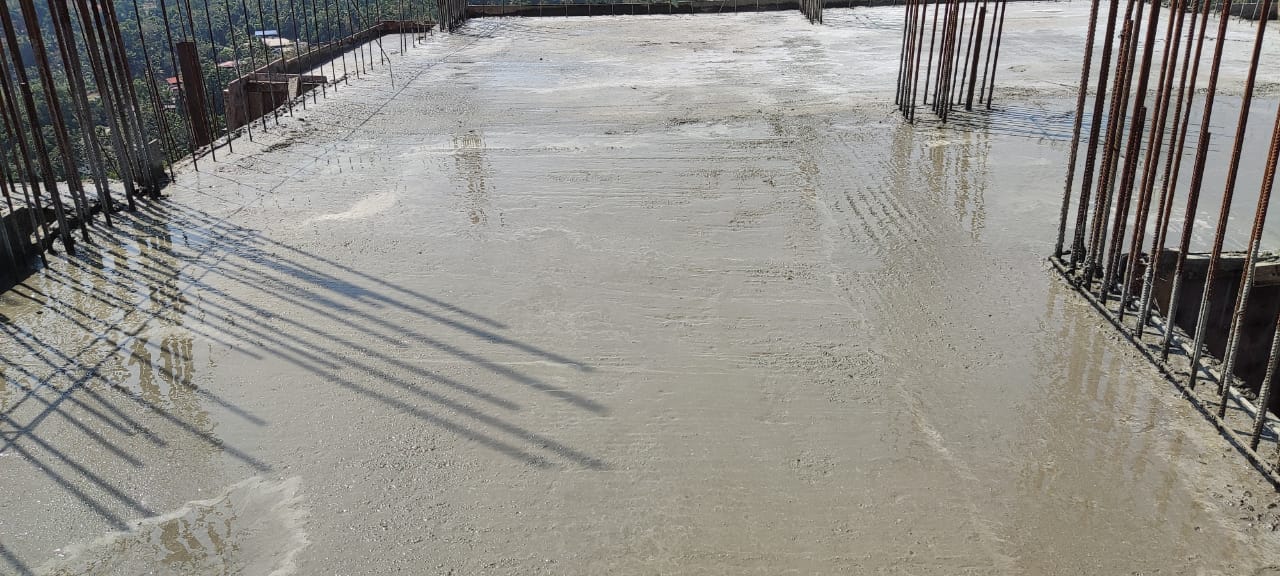

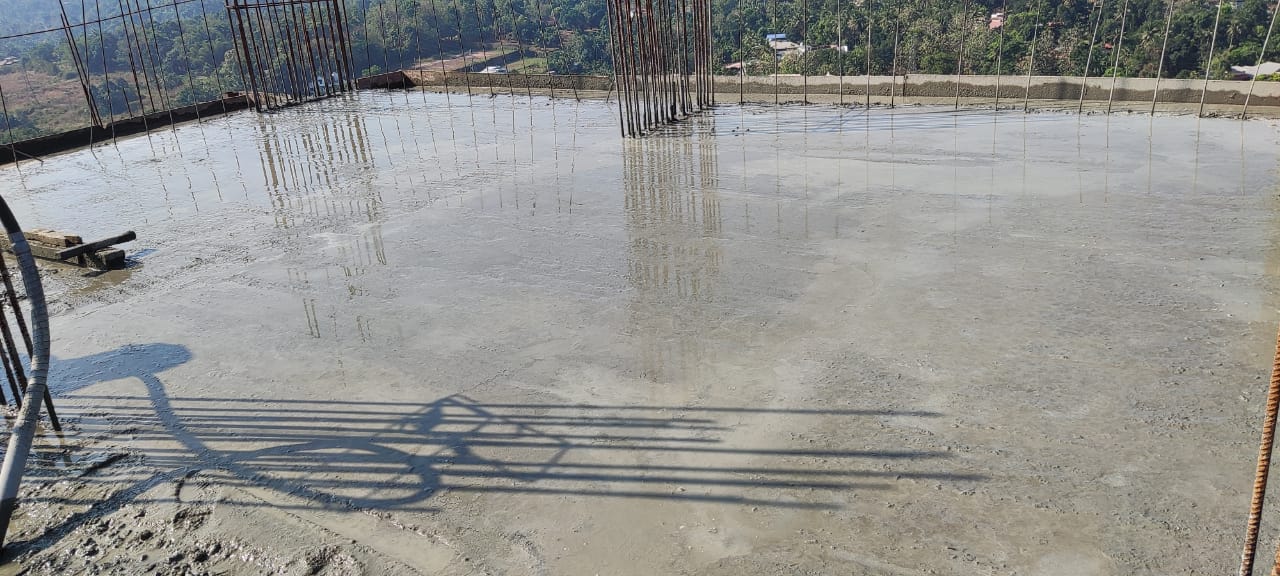

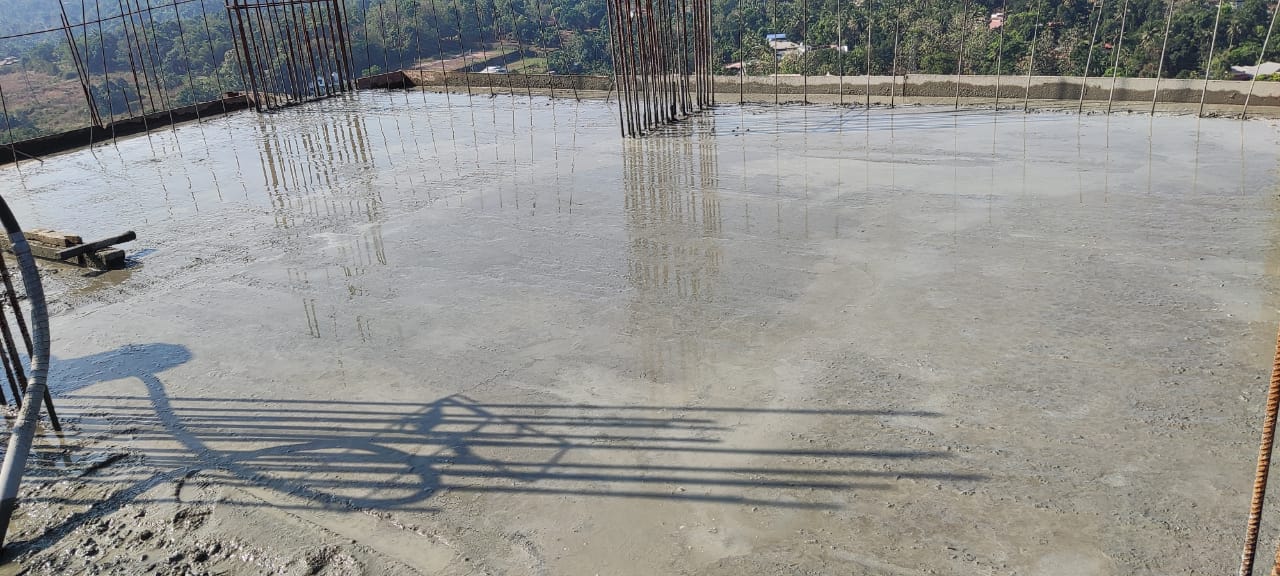

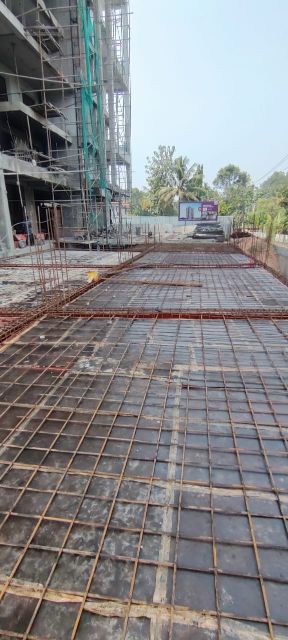

  • Grade slab work – 10% completed

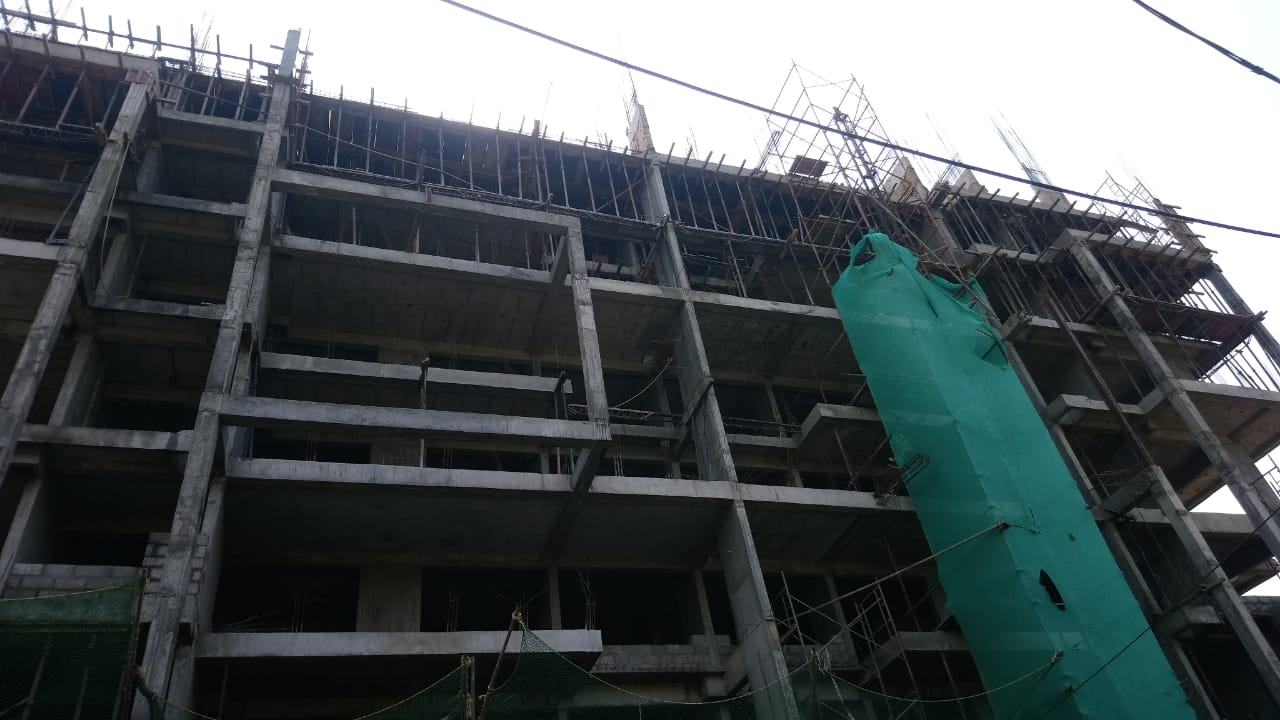

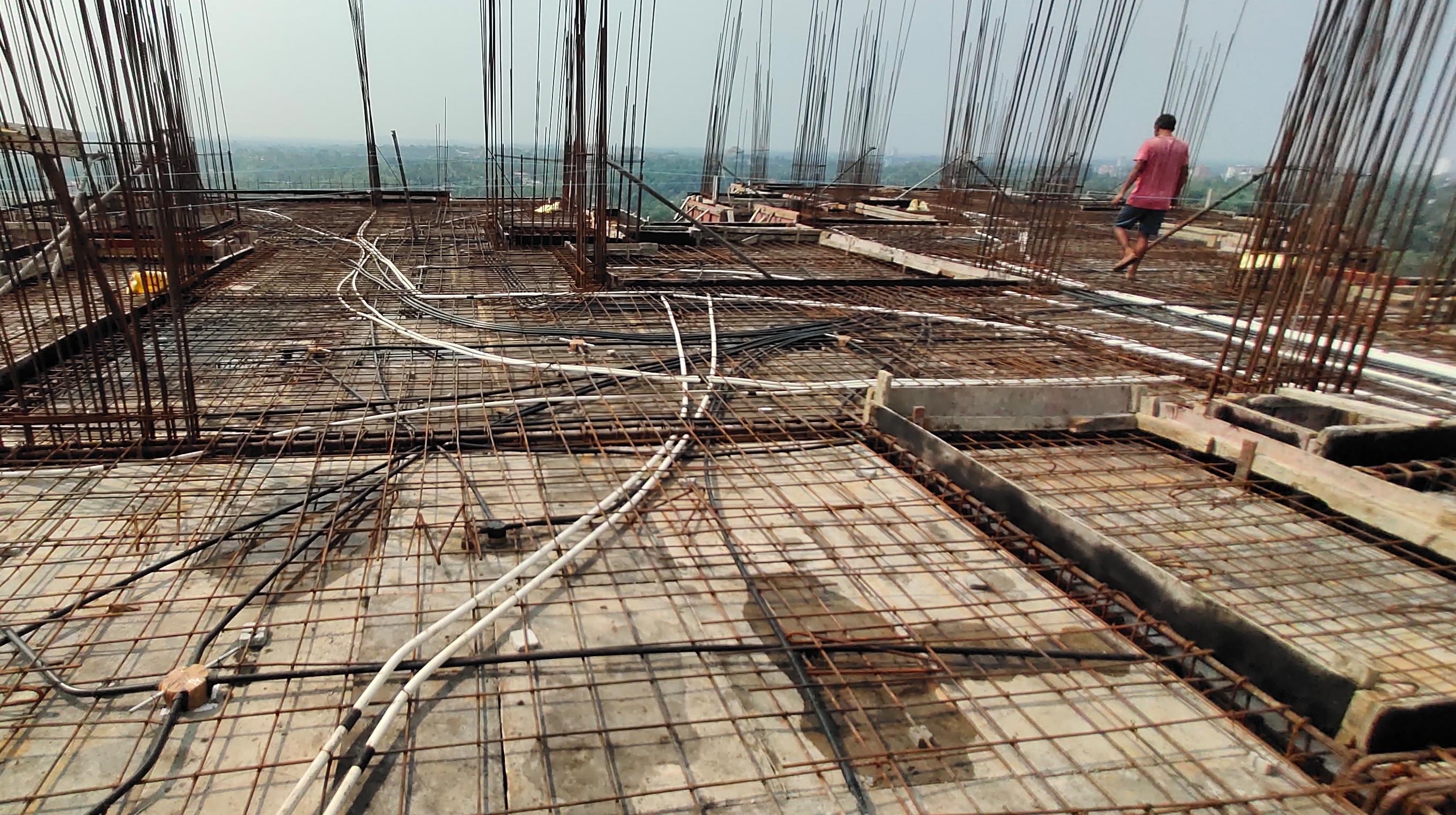

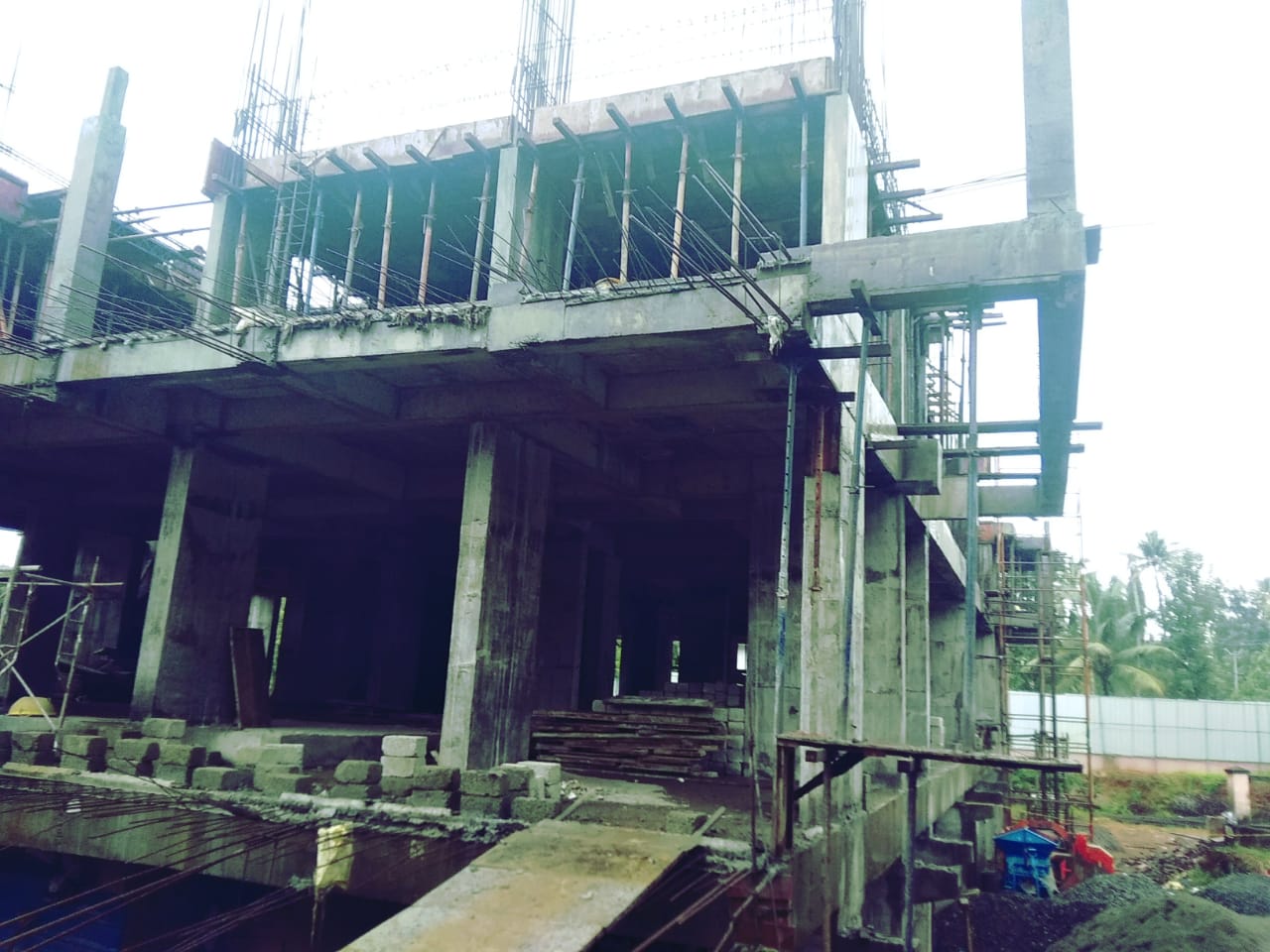

  • BF roof slab work – shuttering work completed

As per the current work status from our site we are targeted to complete the following works by end of November 2018

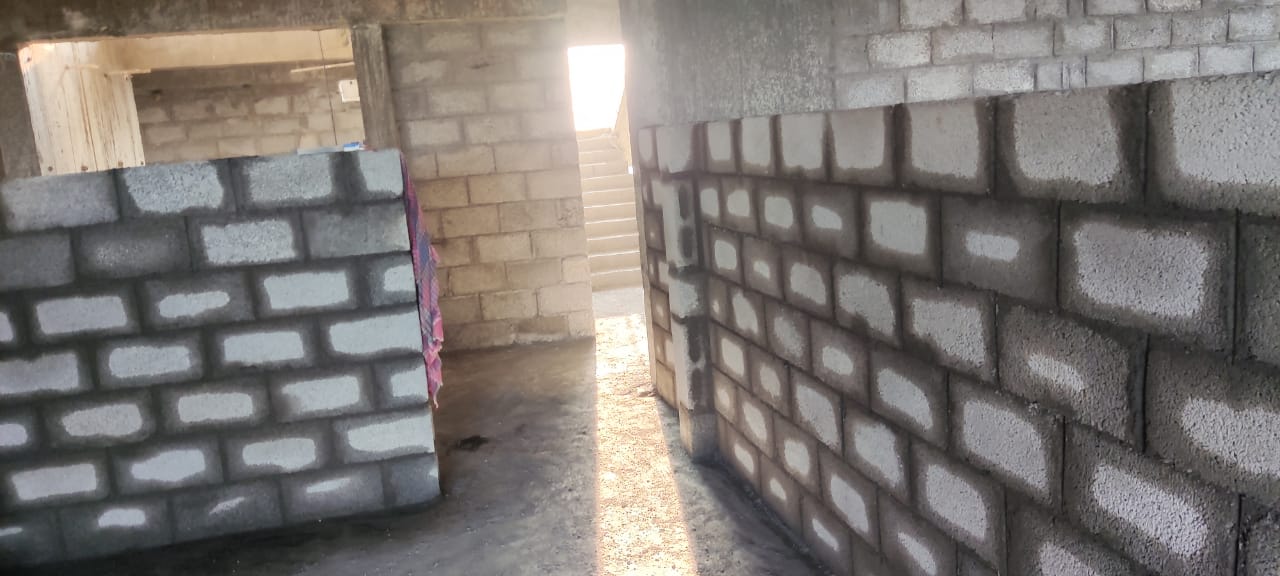

  • Block/Brick masonry – Amenity Block – 100% to be completed

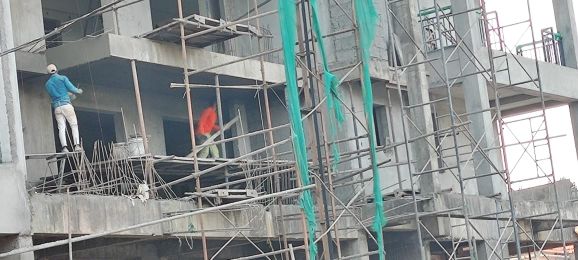

  • Electrical chasing work – 1st floor – 100% to be completed
  • Wire pulling work – 14th & 17th floor – 100% to be completed

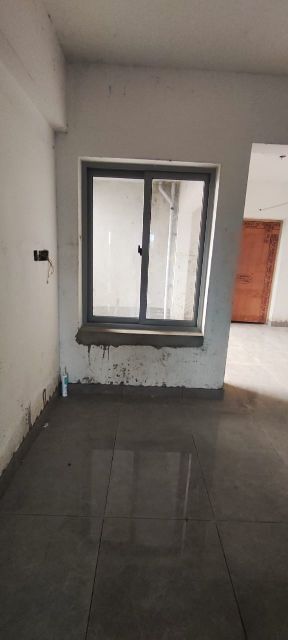

  • Tiling work – 1st & 19th floor – 100% to be completed
  • External plastering work – 100% to be completed

Work status as on 15-11-2018, we have completed the following.

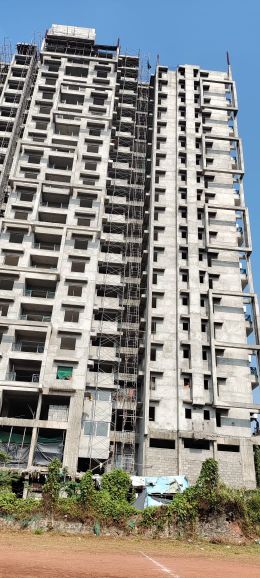

  • RCC for Structure – Amenity Block – 90% completed

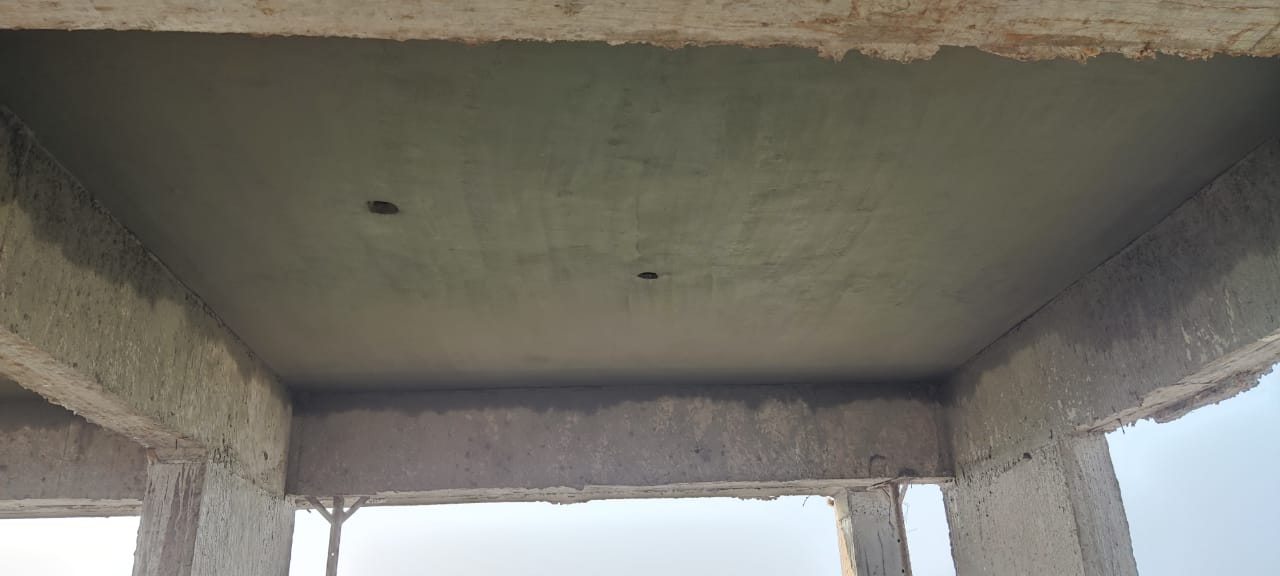

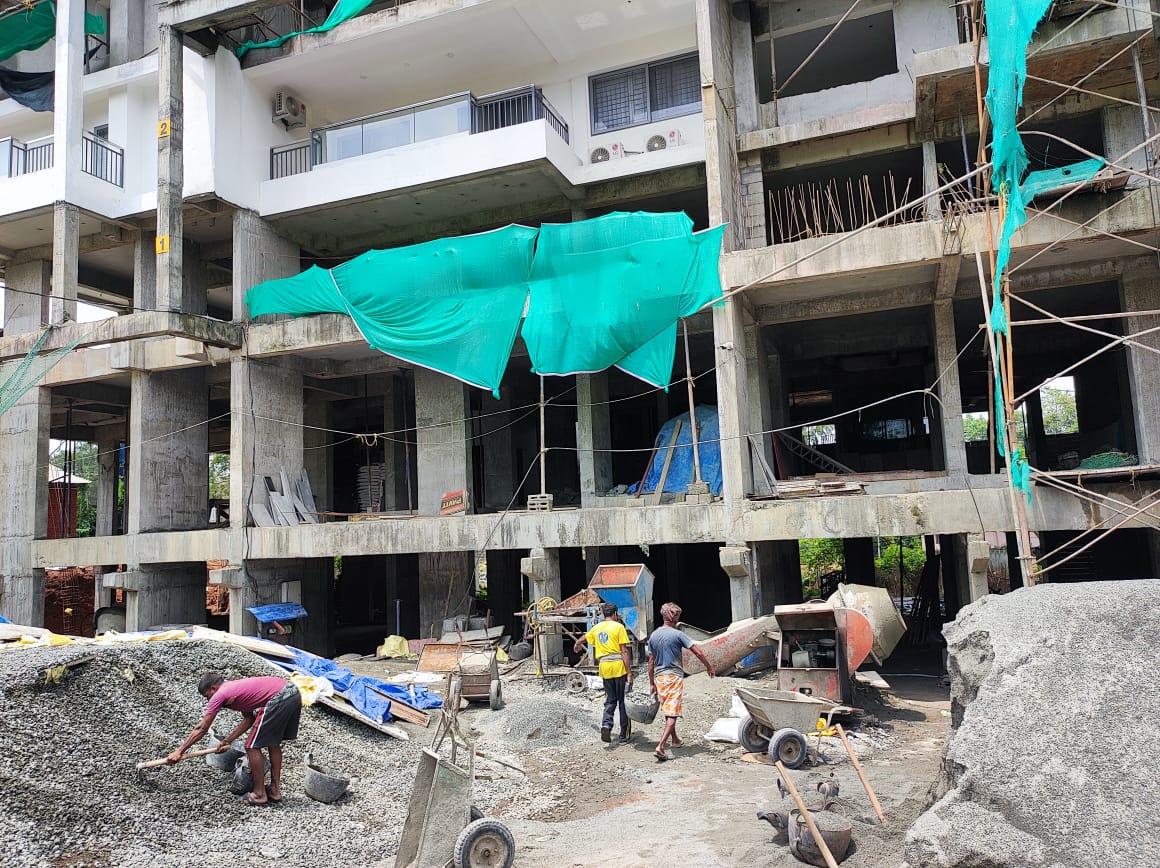

  • Ceiling plastering work – 100% completed
  • Block/Brick masonry – Amenity Block – 90% completed
  • Electrical chasing work – 1st floor (95% completed); 2nd to 19th floor (completed)
  • Wall plastering work – GF to 19th floor – 100% completed
  • Wire pulling work – SF to 13th (100% completed); 14th floor (70% completed); 15th floor (completed); 16th floor (40% completed); 17th floor (60% completed); 18th floor (20% completed)
  • Tiling work – GF (90% completed); FF (90% completed); 19th floor (95% completed)

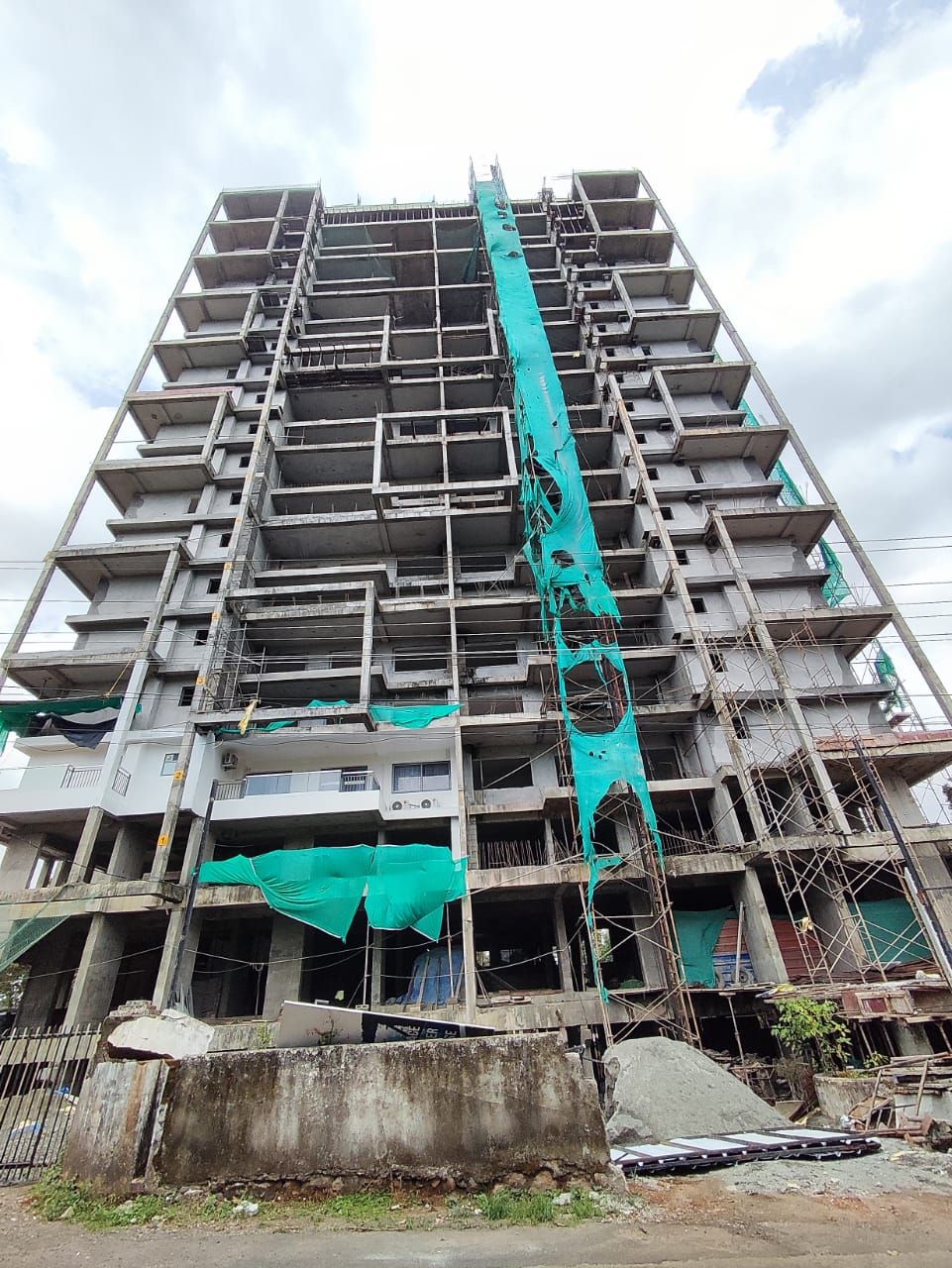

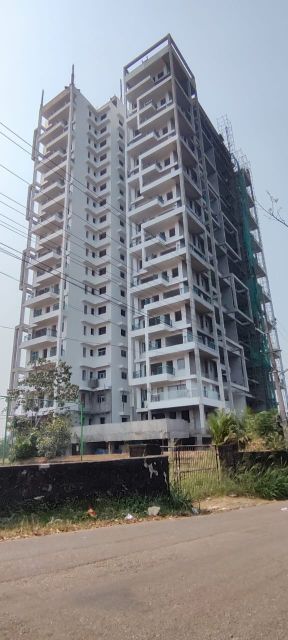

  • External plastering work – 95% completed

Work Schedule for the Month of July 2018

  • Pile cap work – 20% to be completed
  • Pile chipping work – 50% to be completed

 Work status as on 05-06-2018, we have completed the following.

  • Piling work – 100% completed
  • Pile cap RCC work – started
  • Pile chipping work – 20% completed
