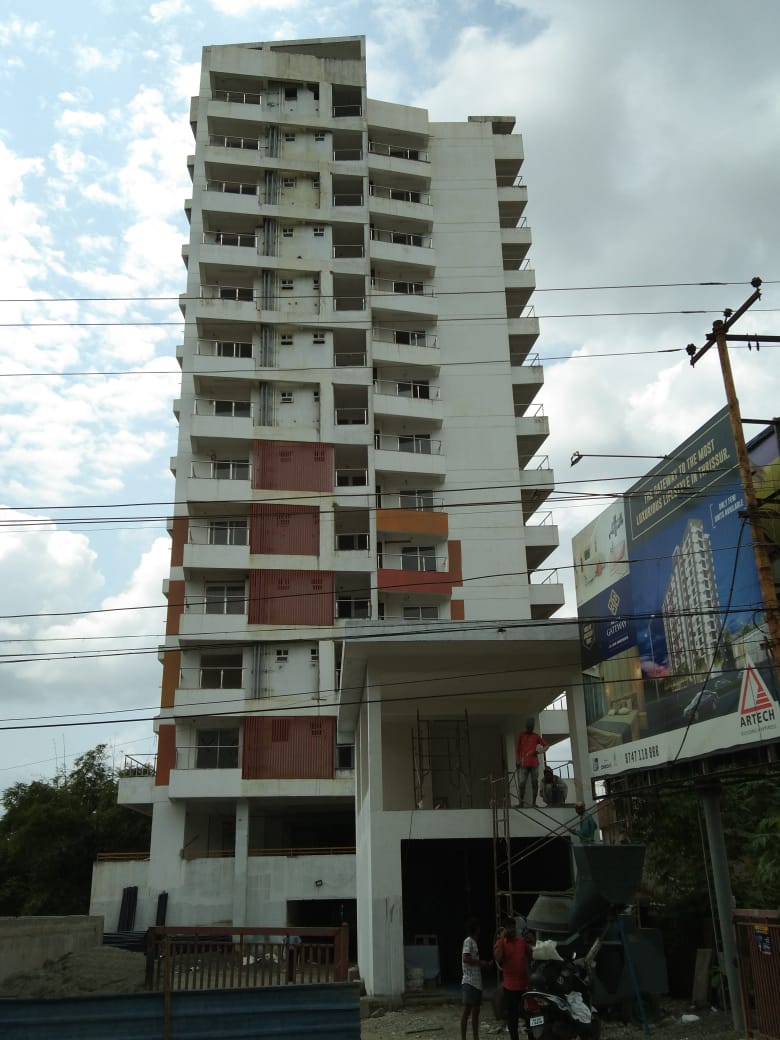

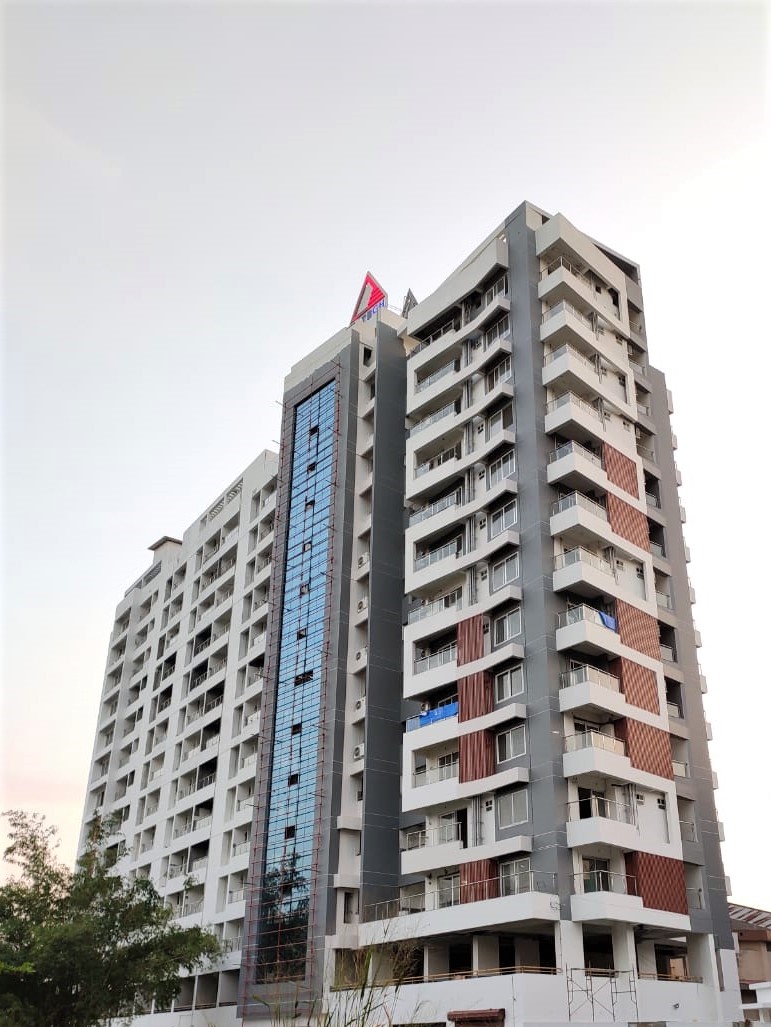

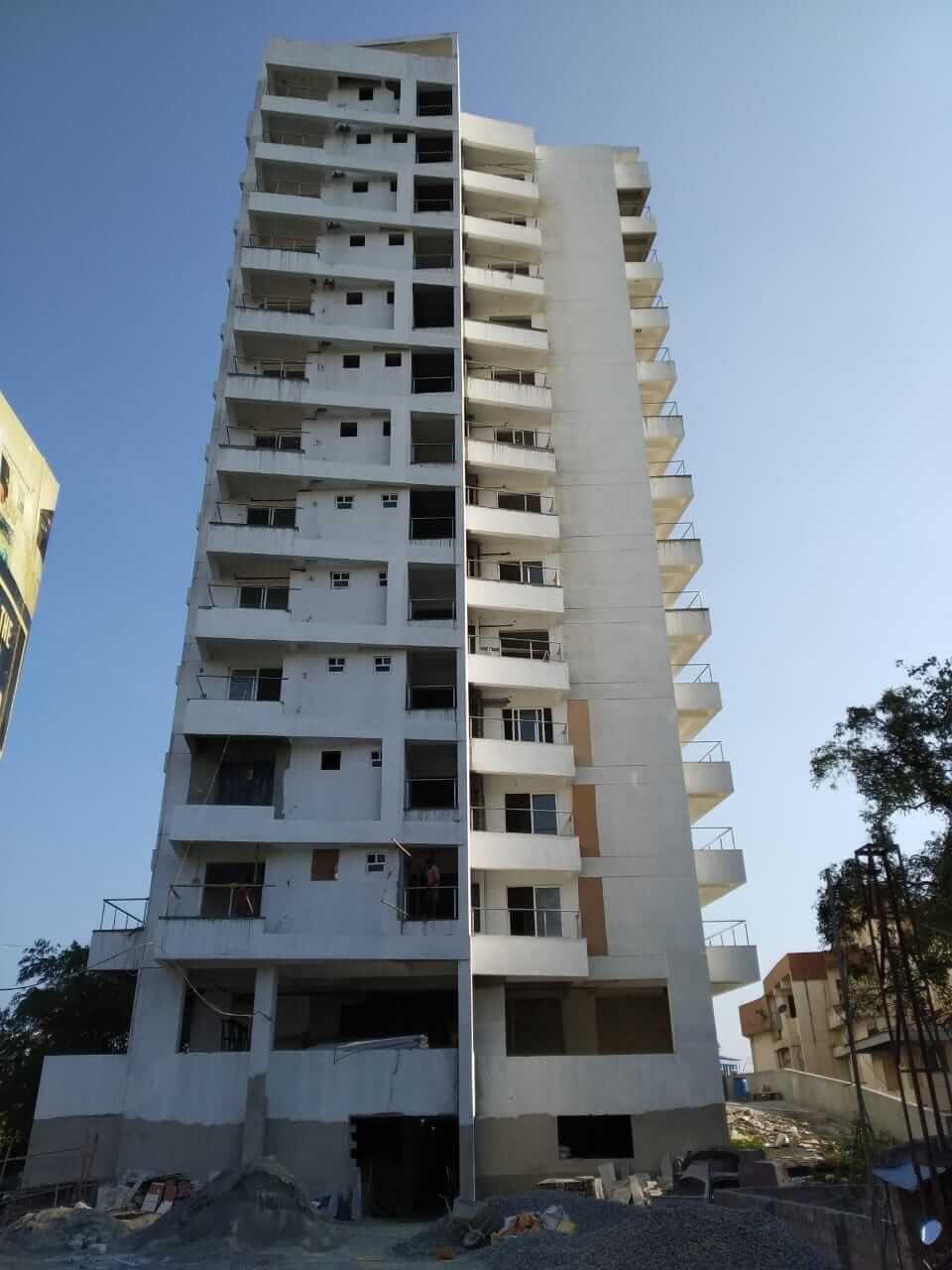

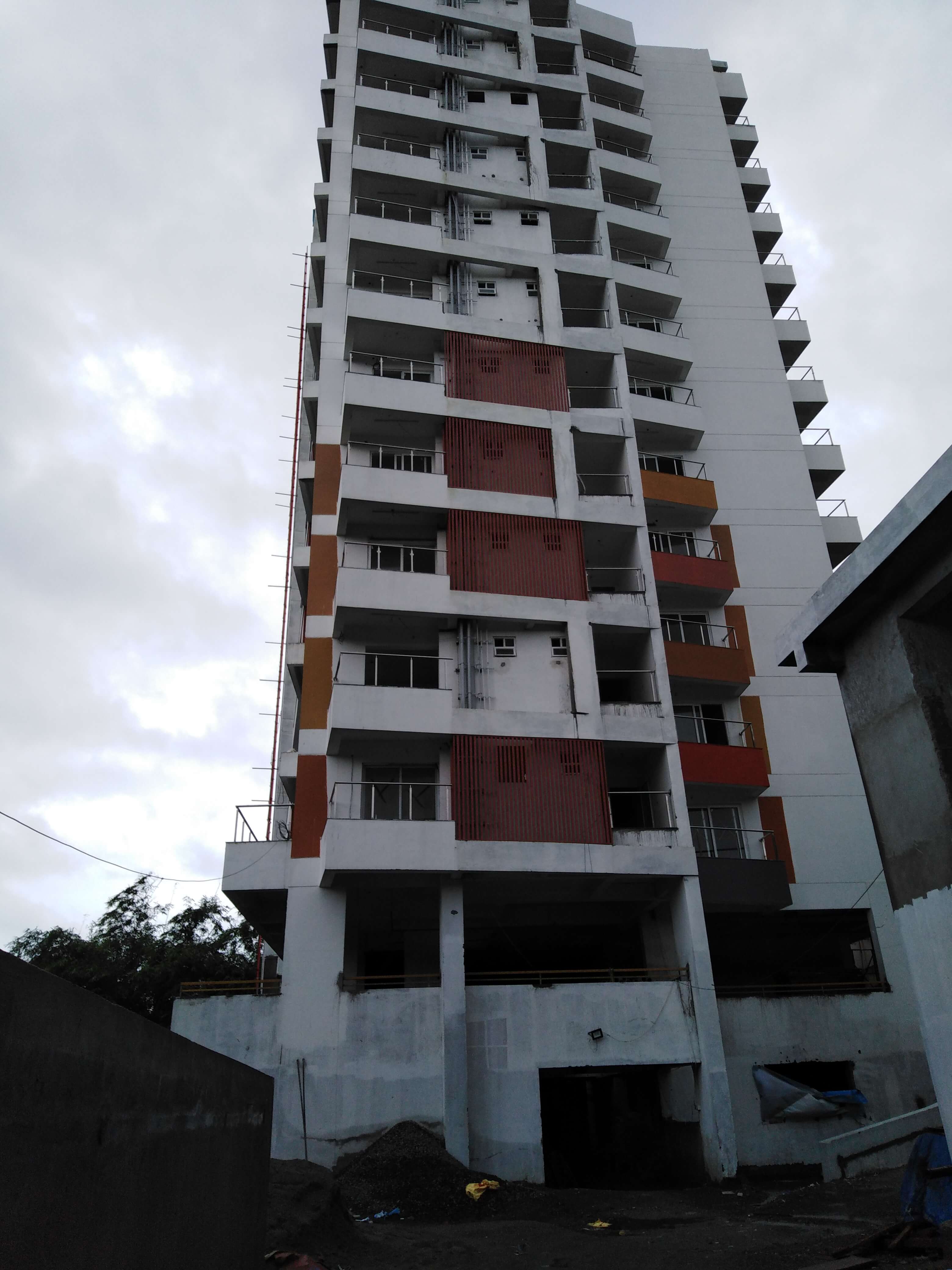

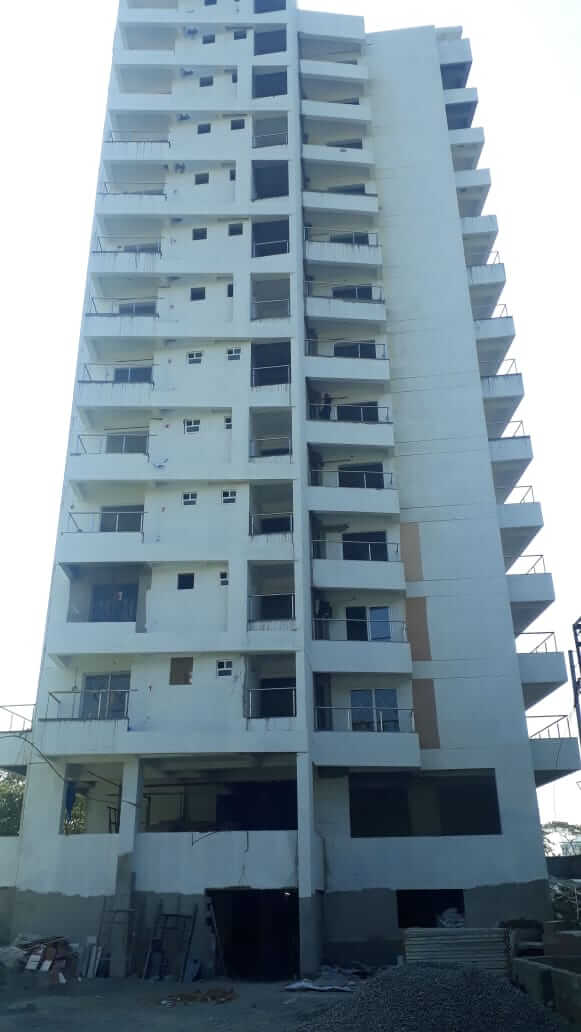

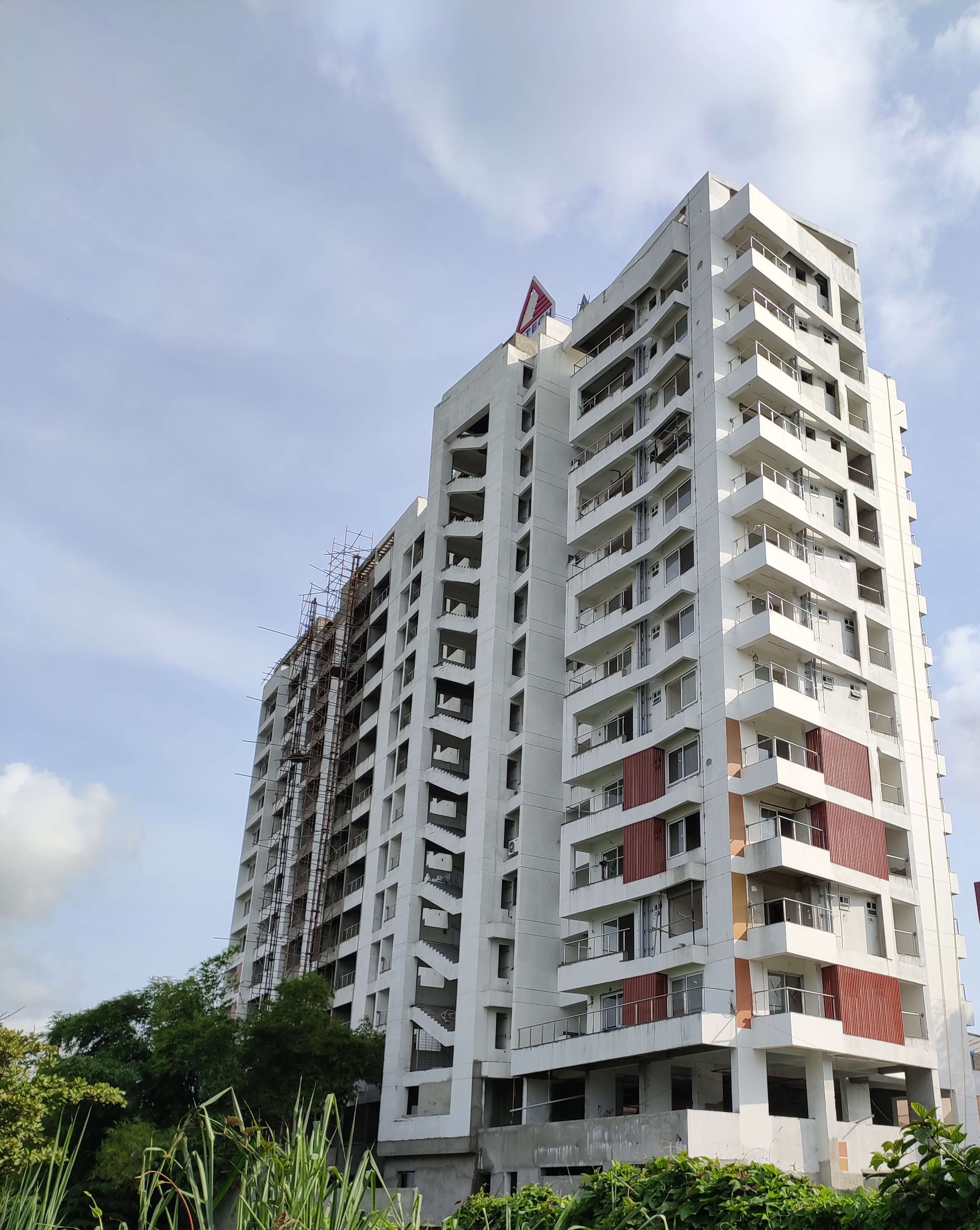

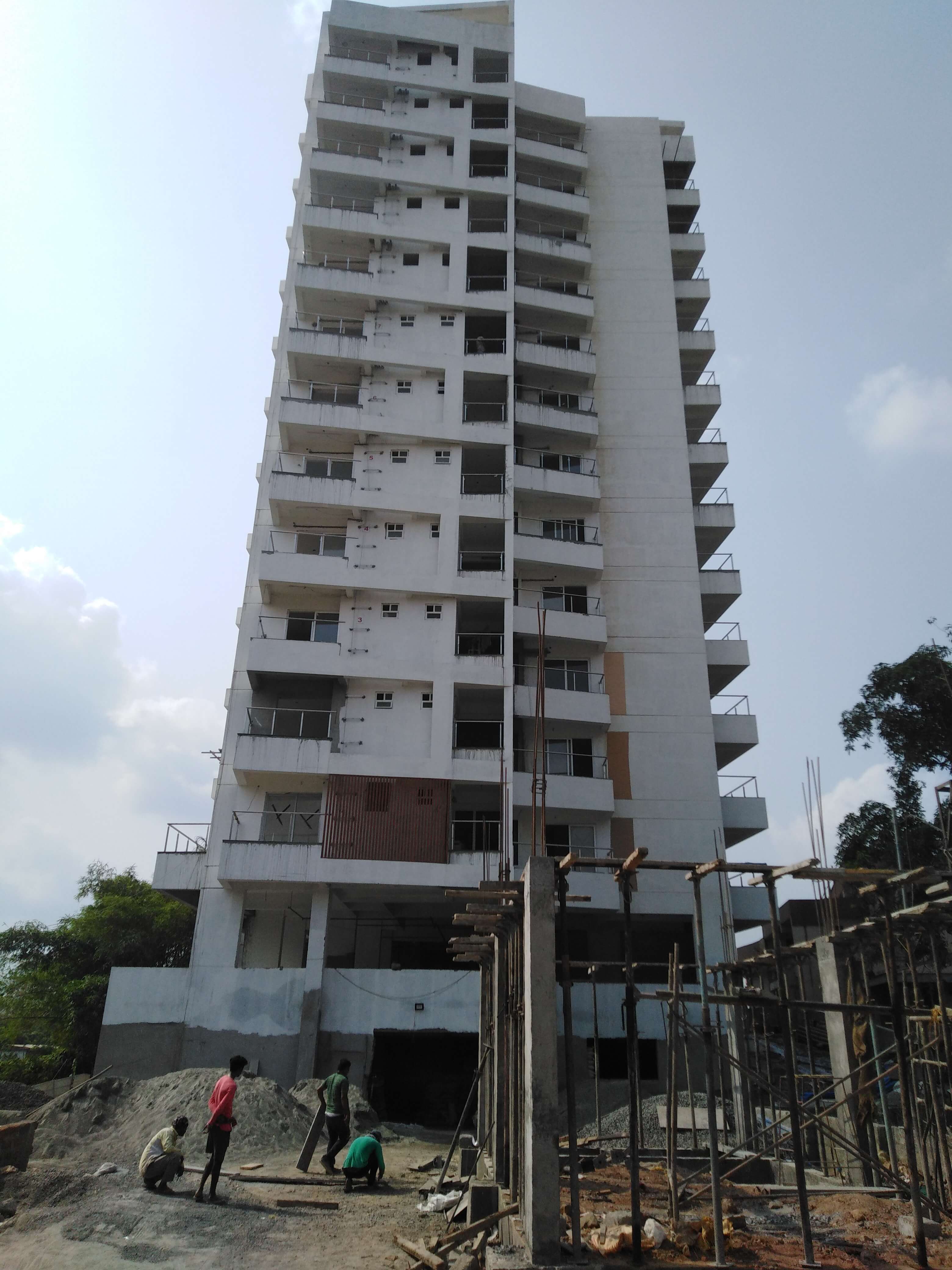

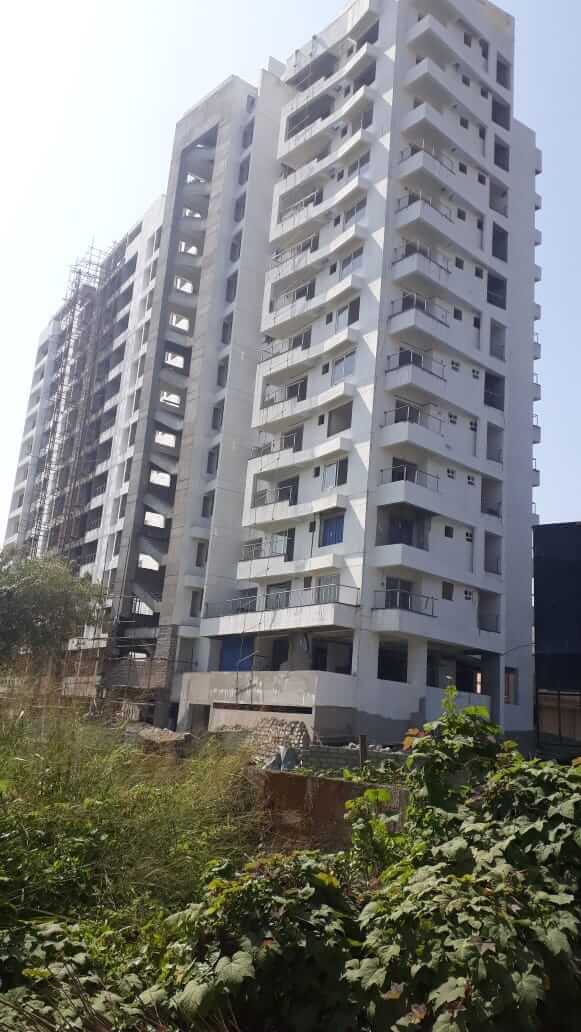

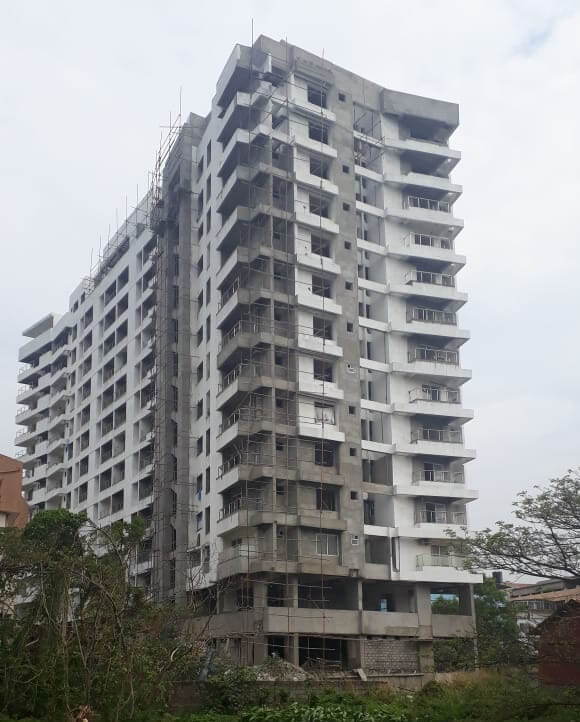

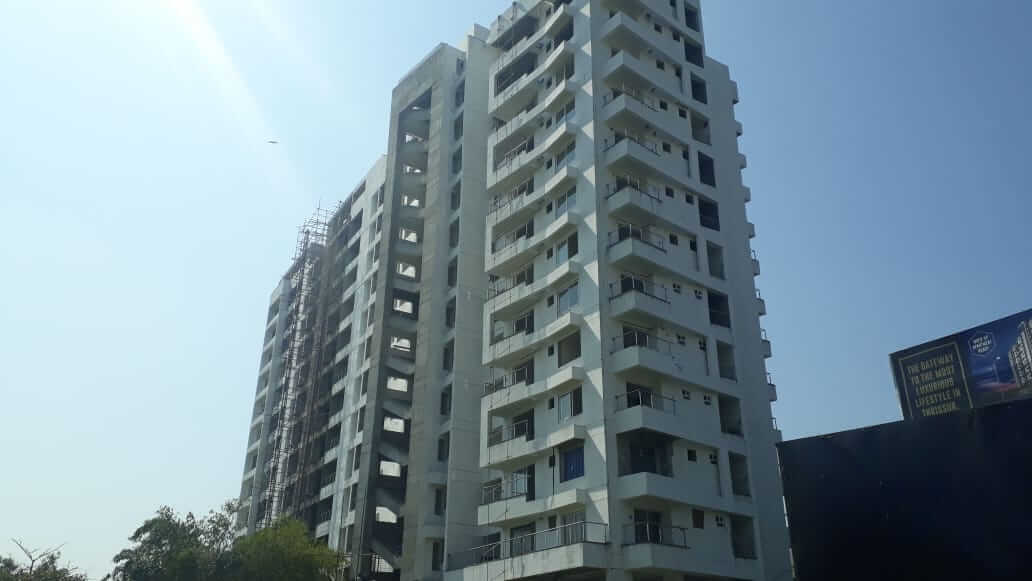

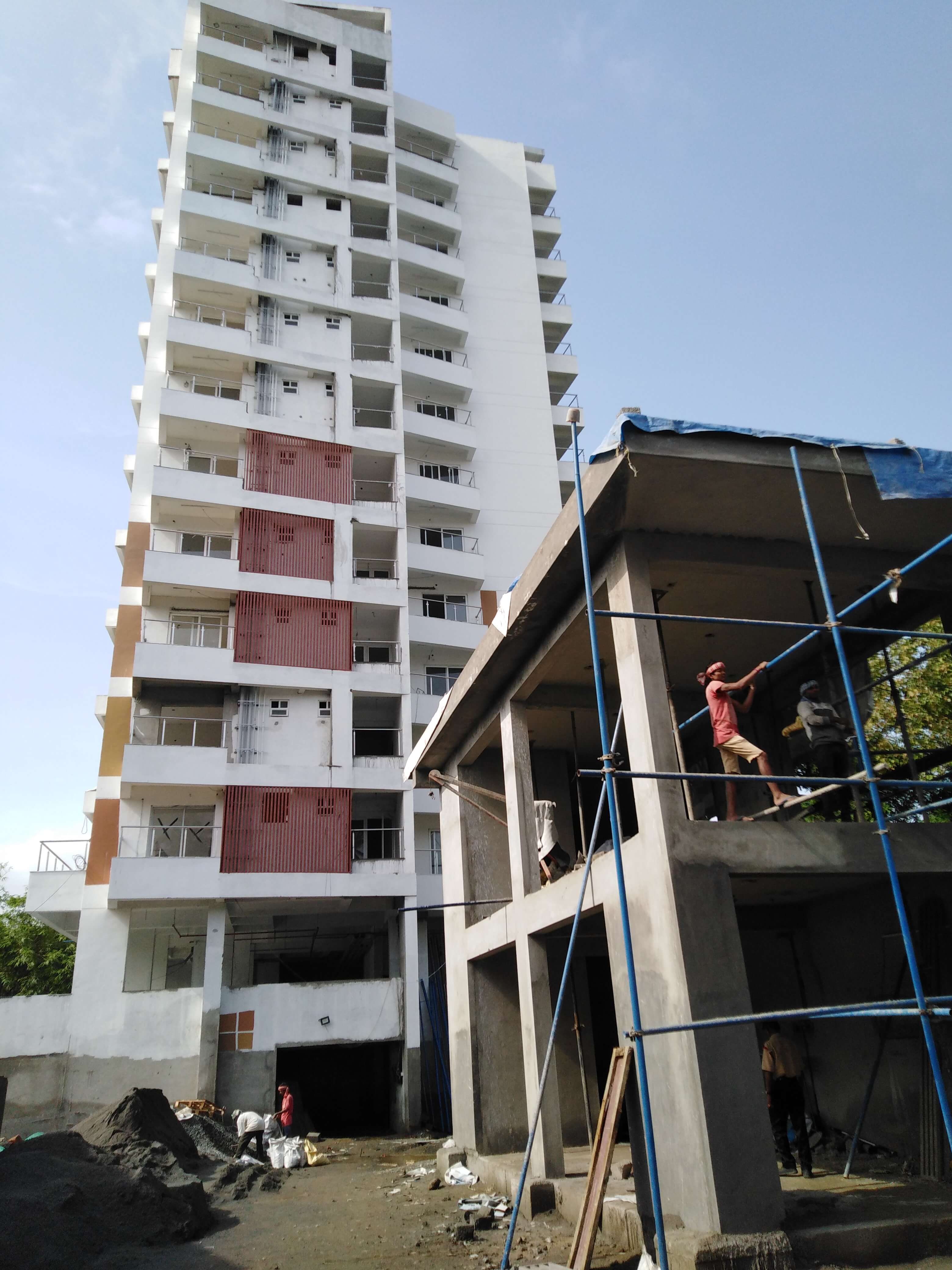

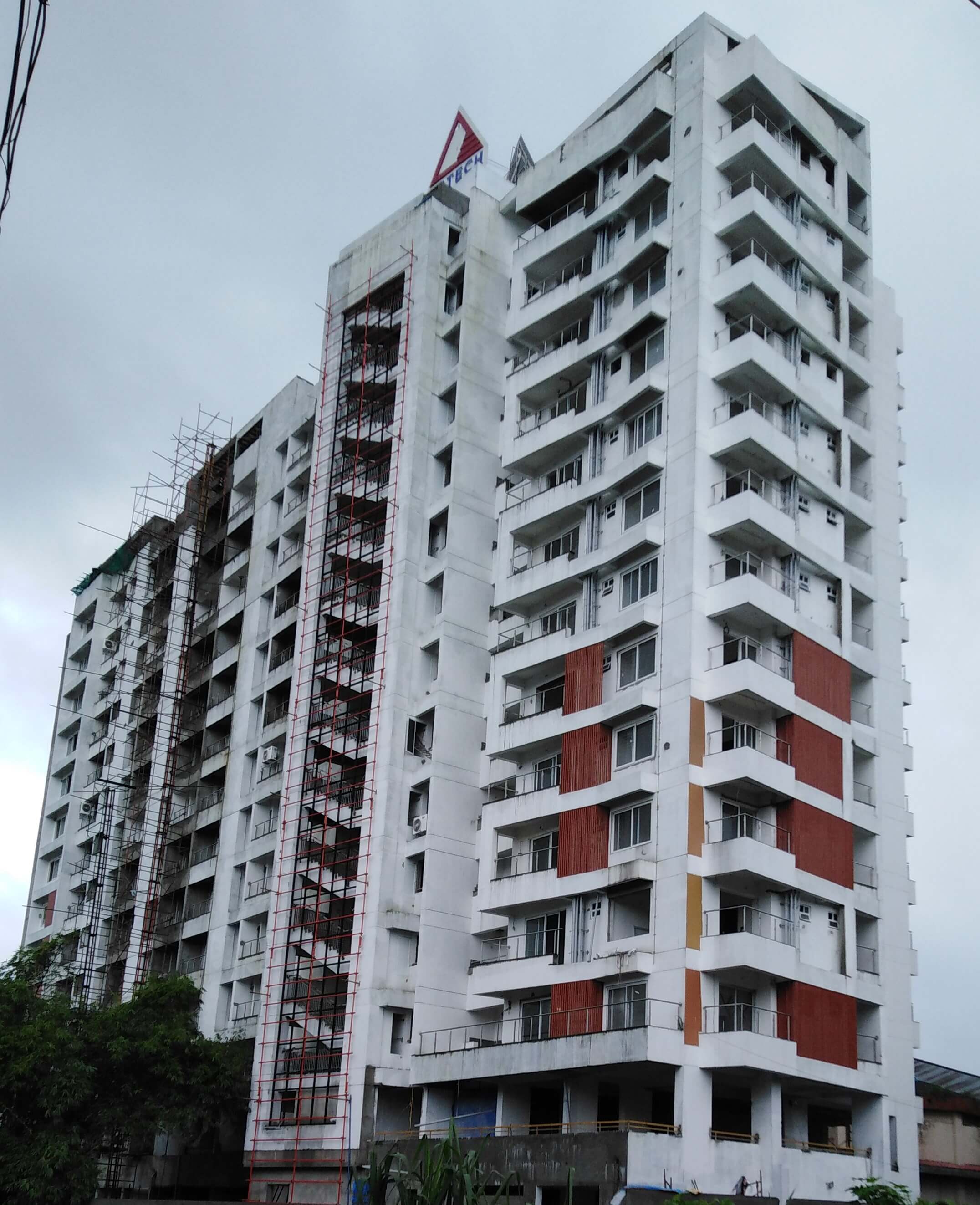

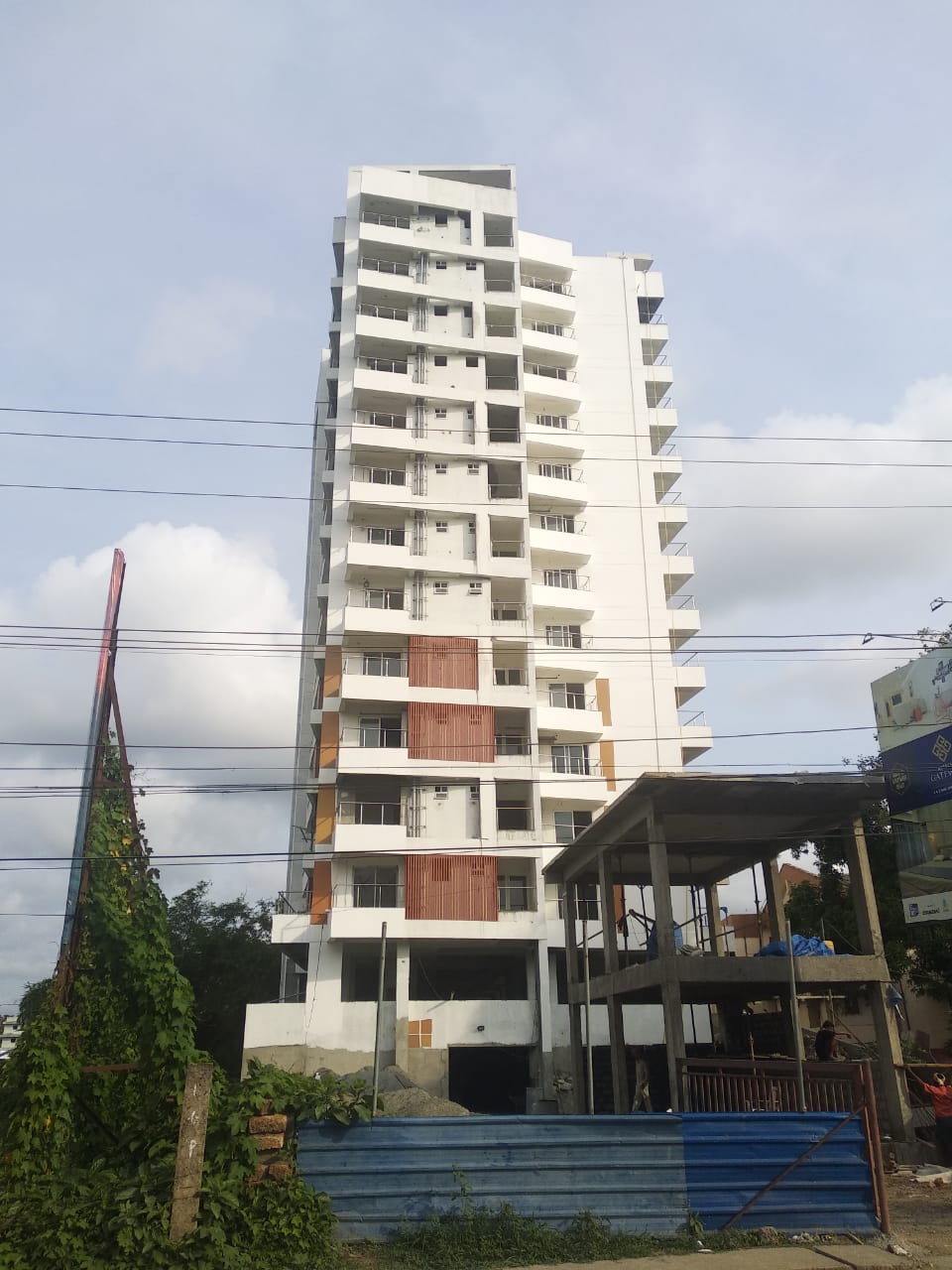

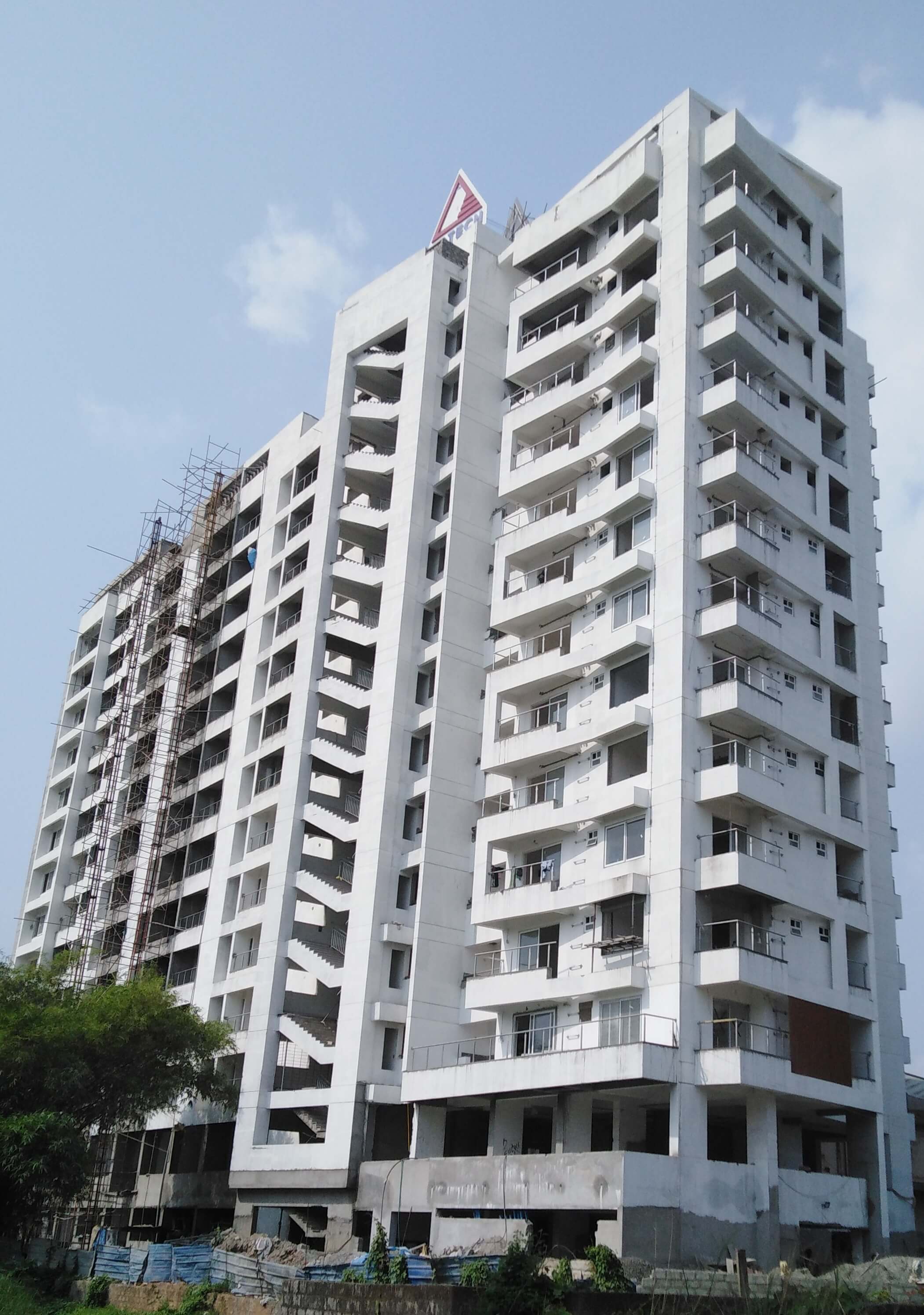

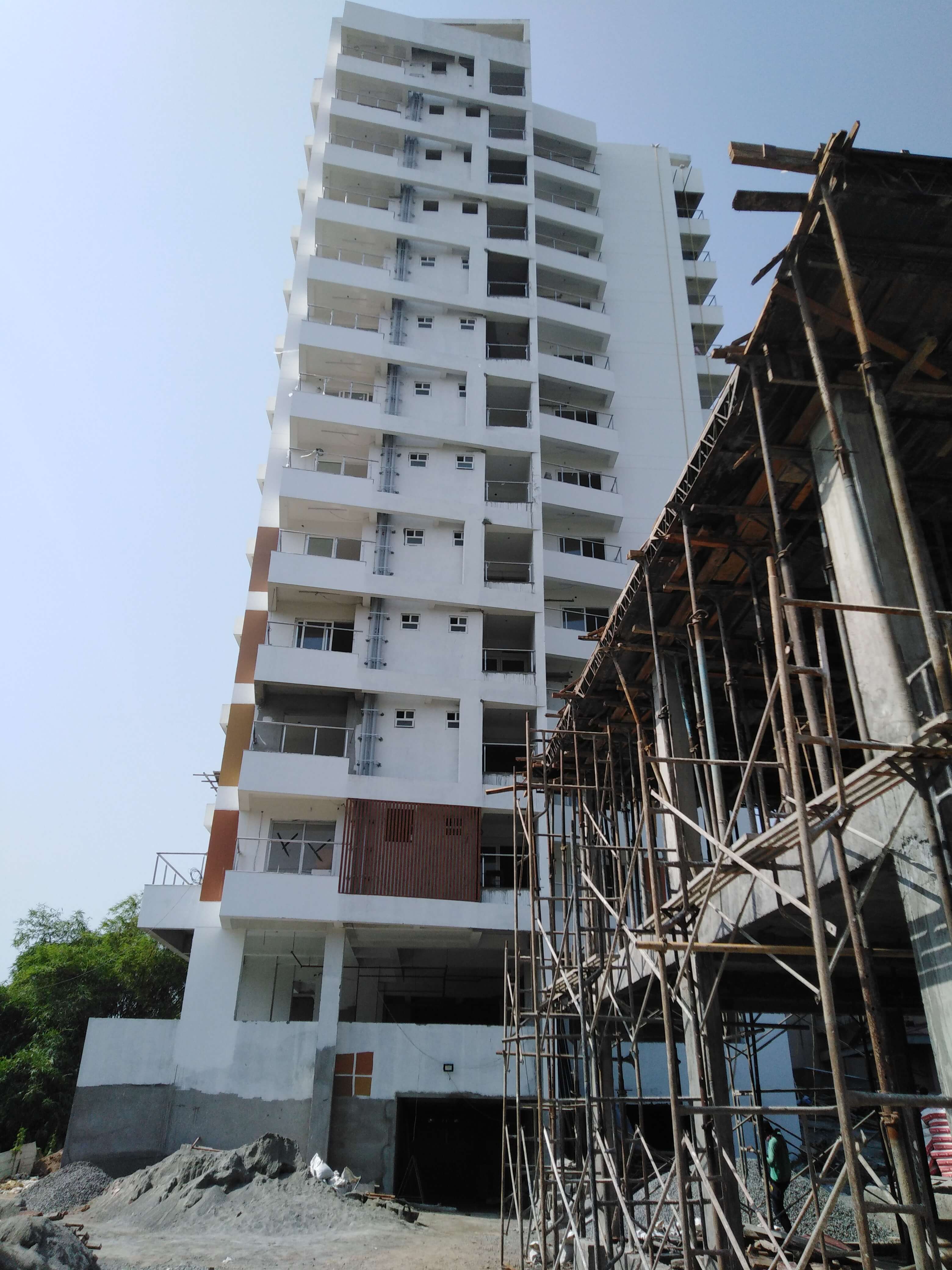

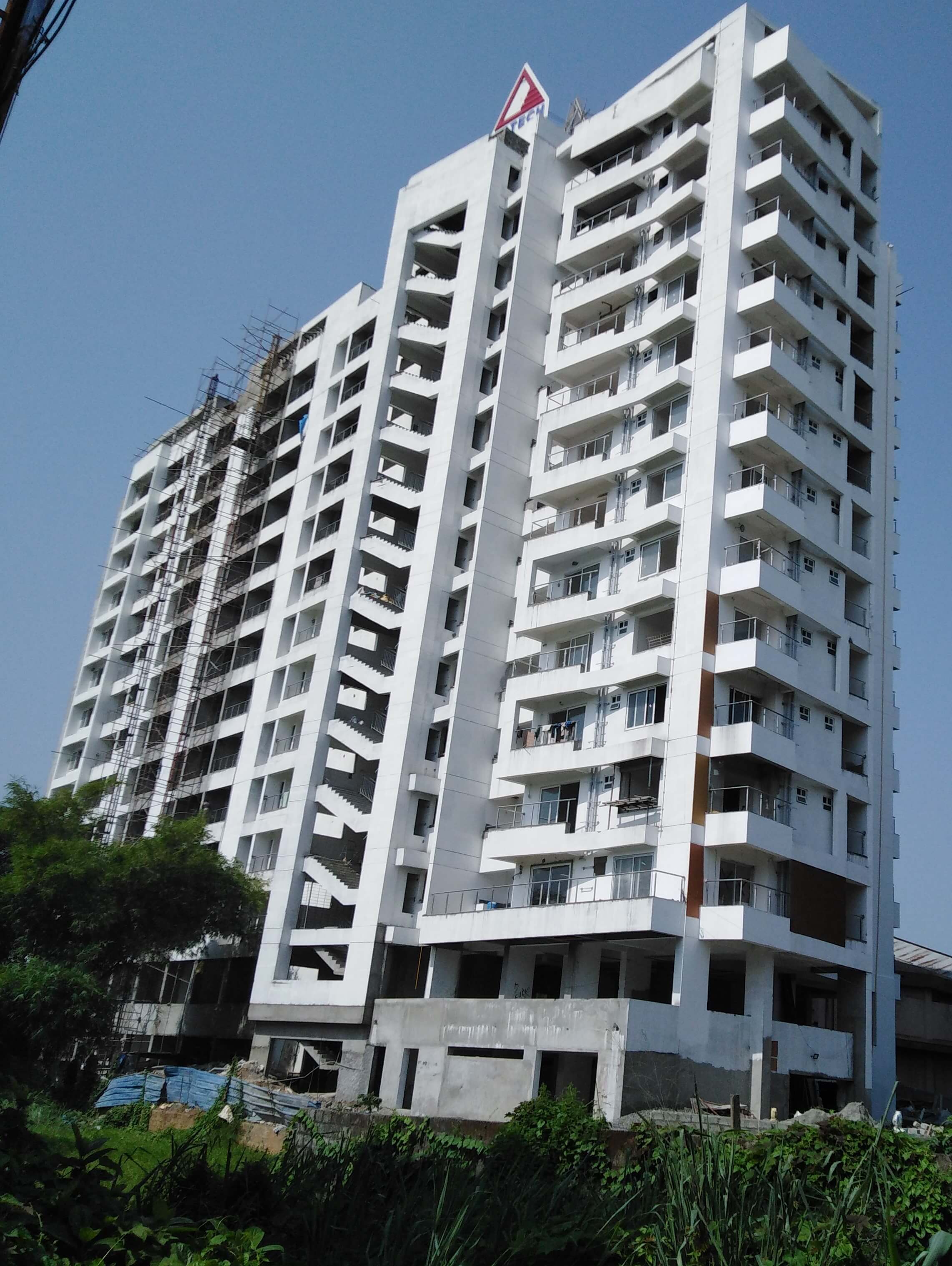

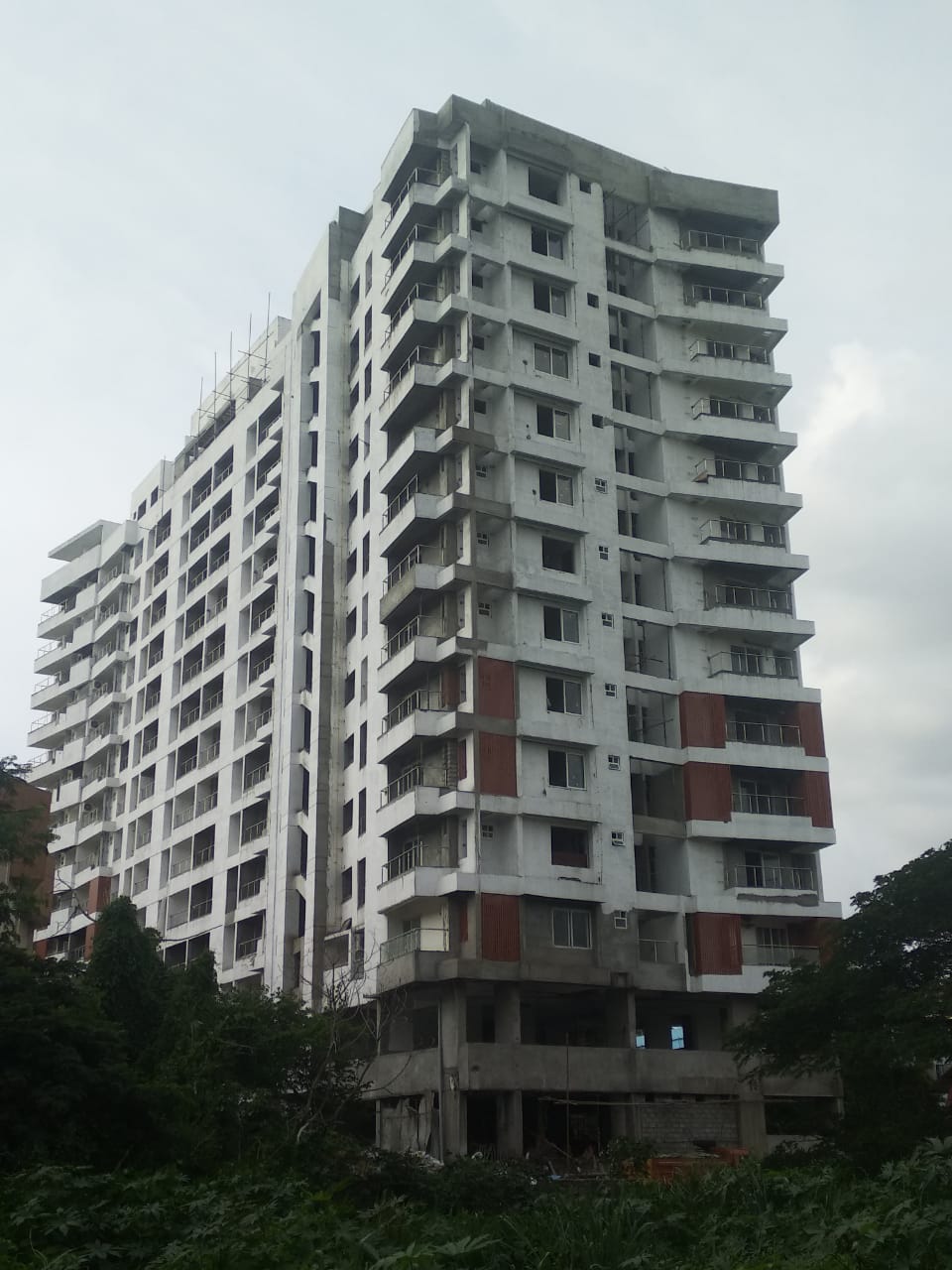

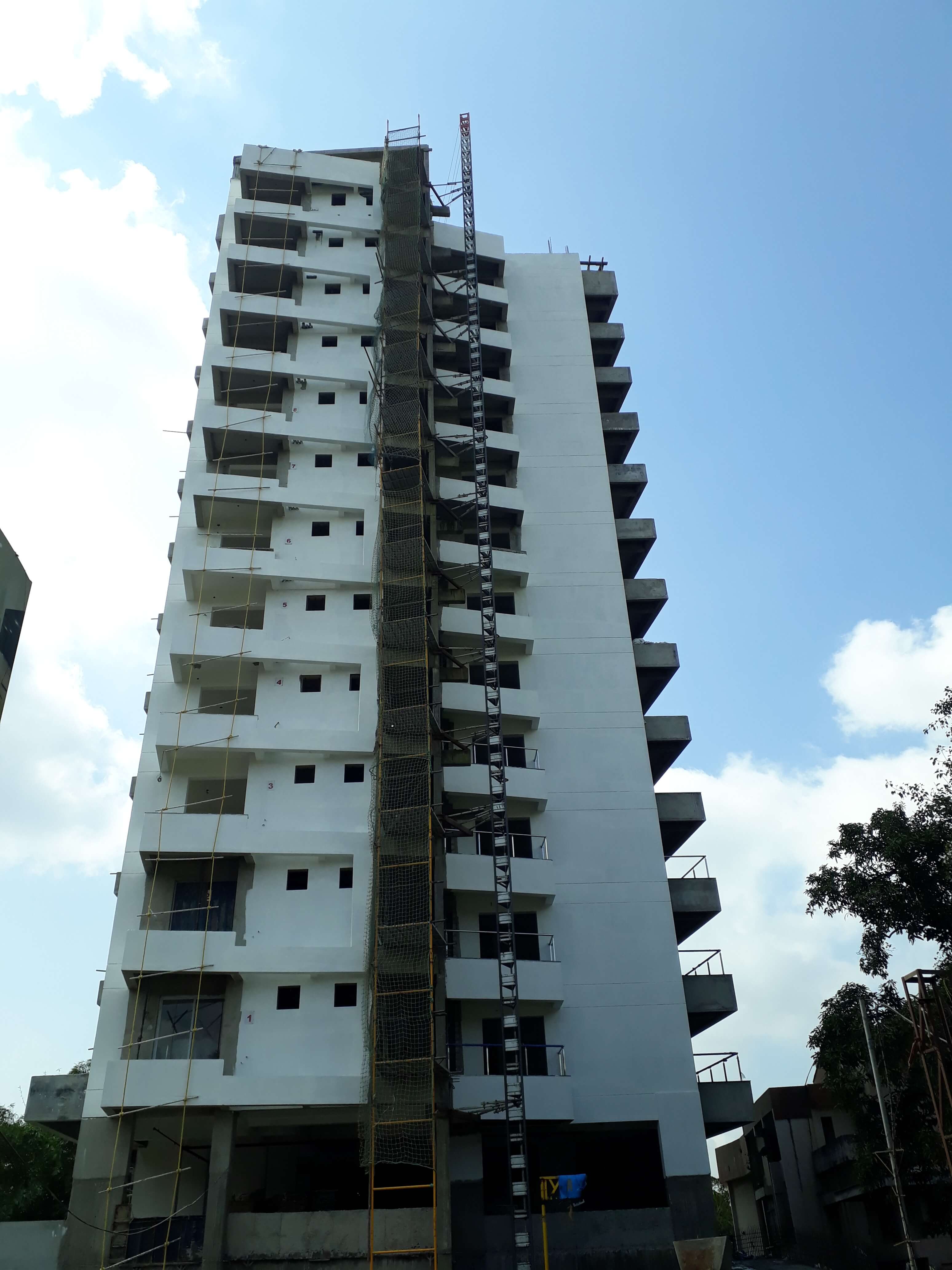

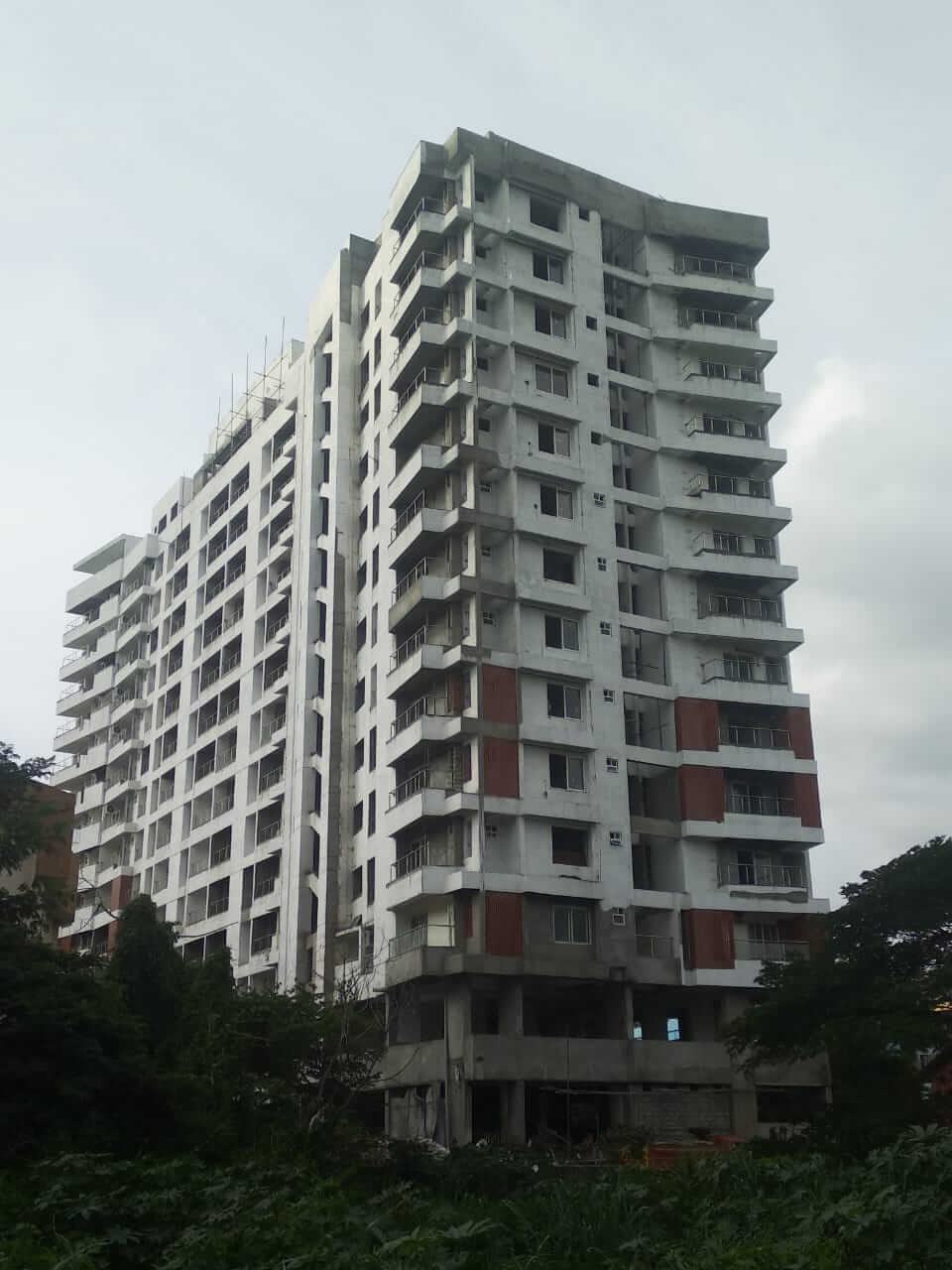

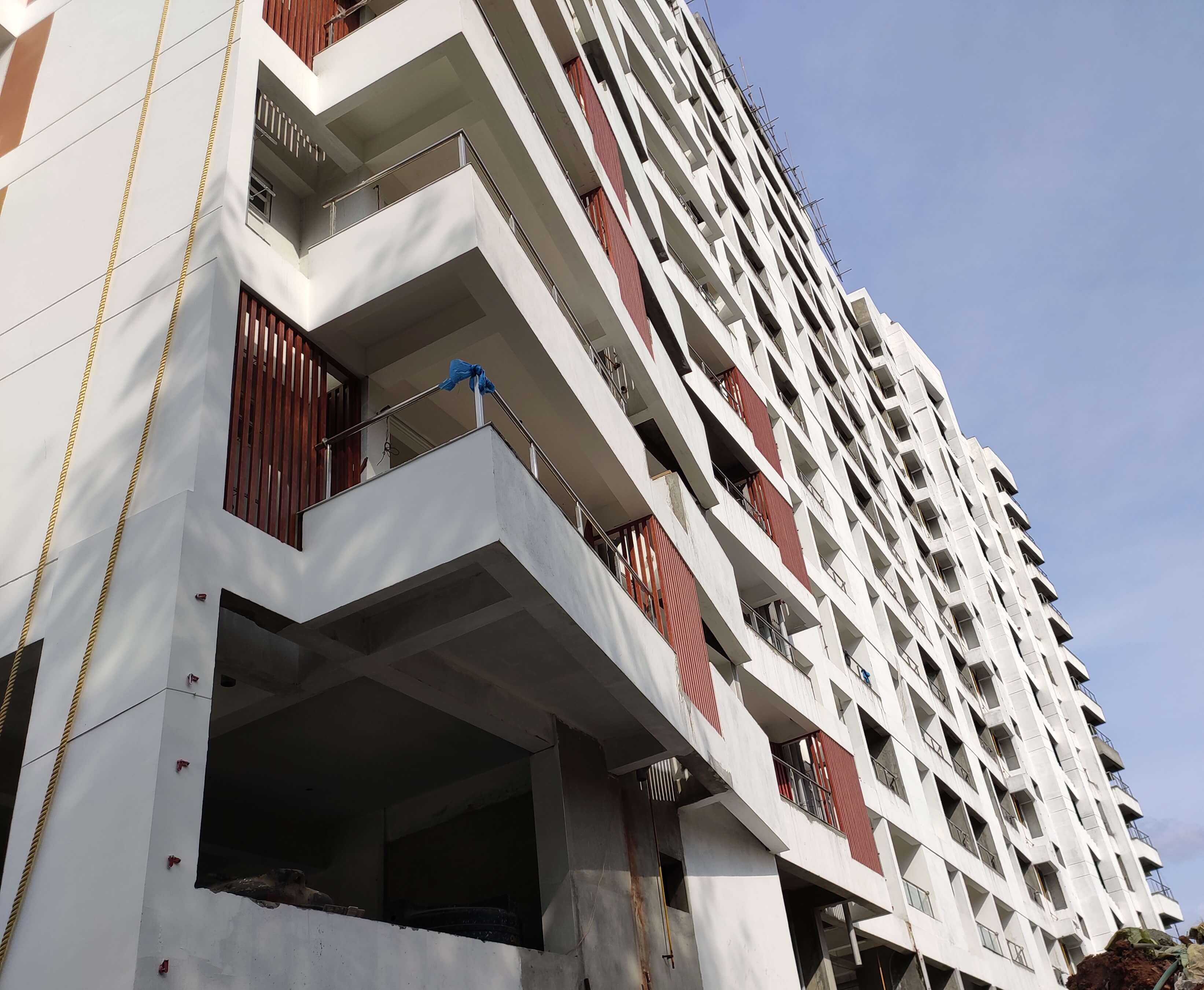

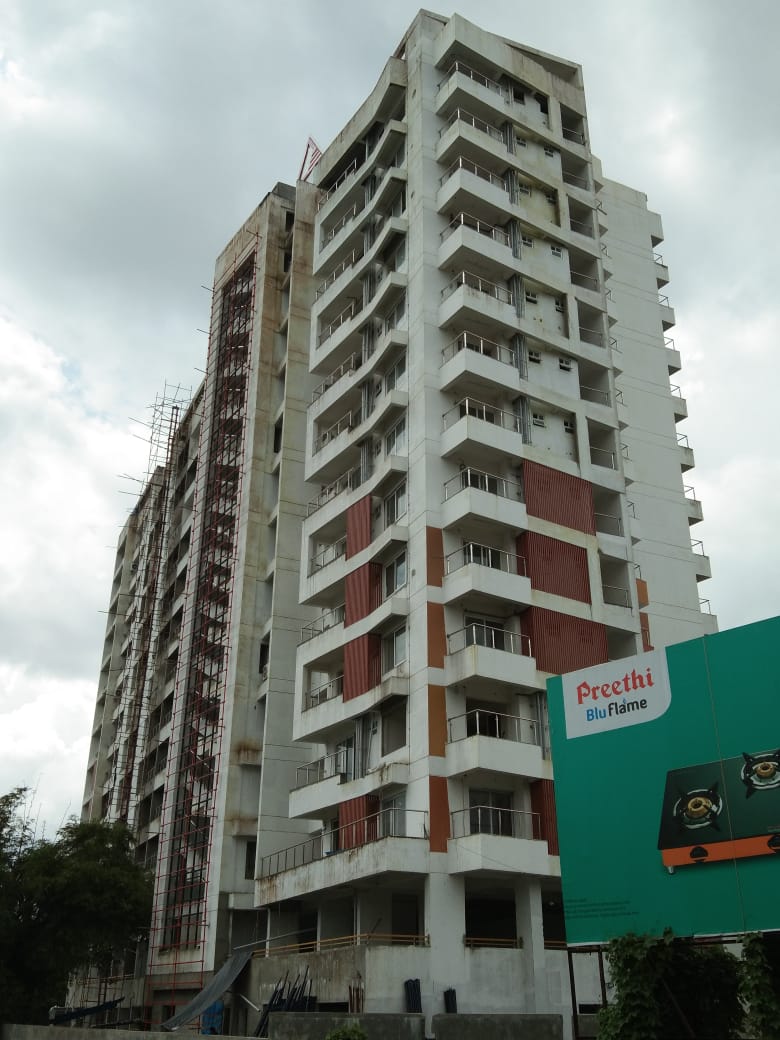

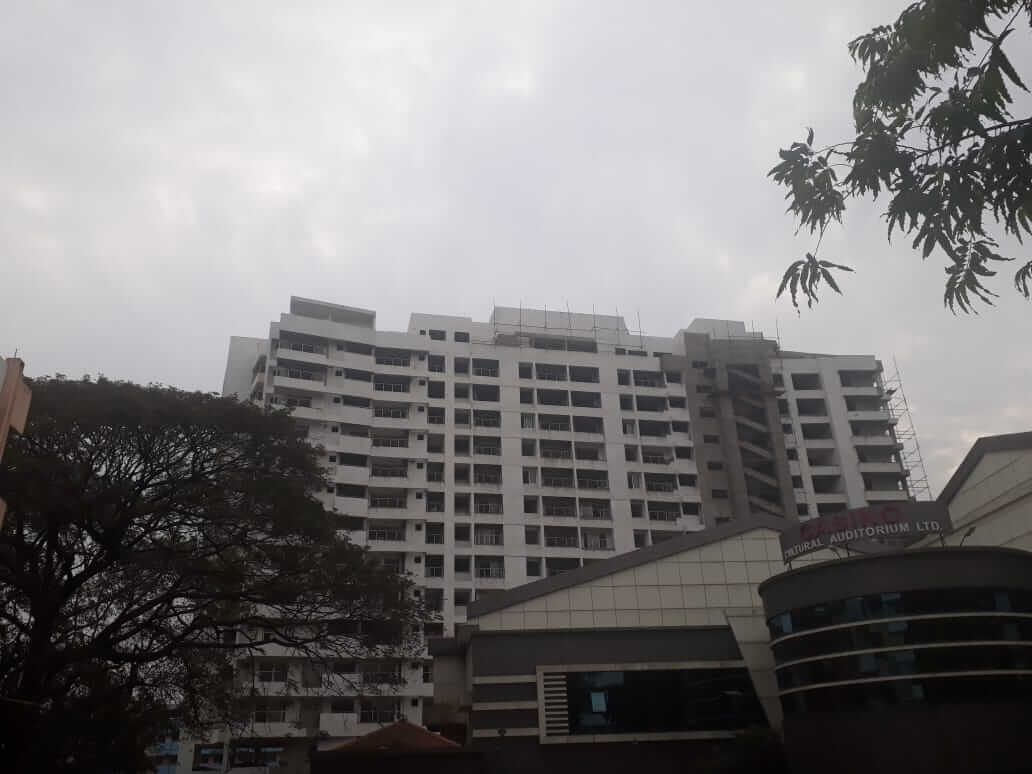

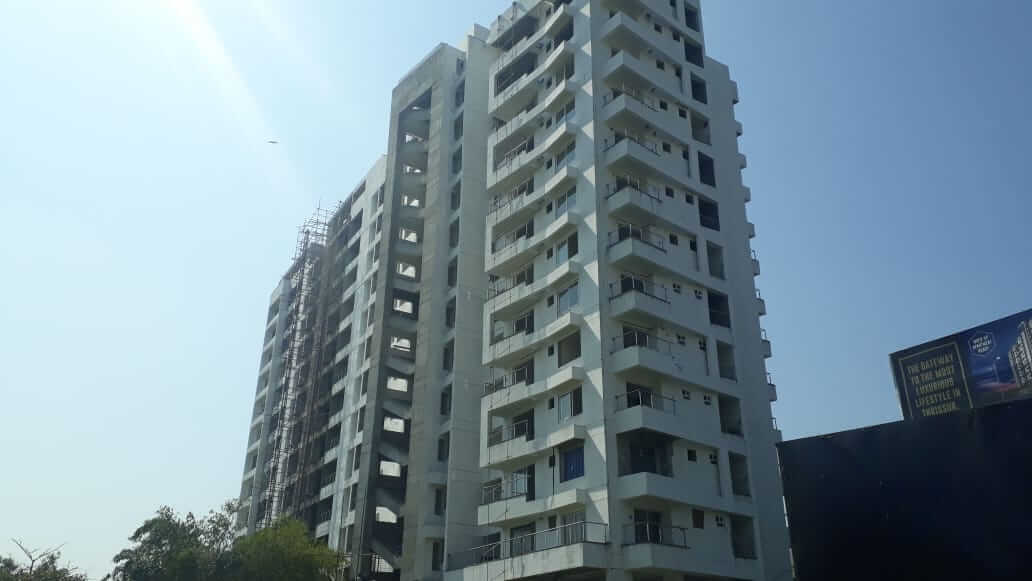

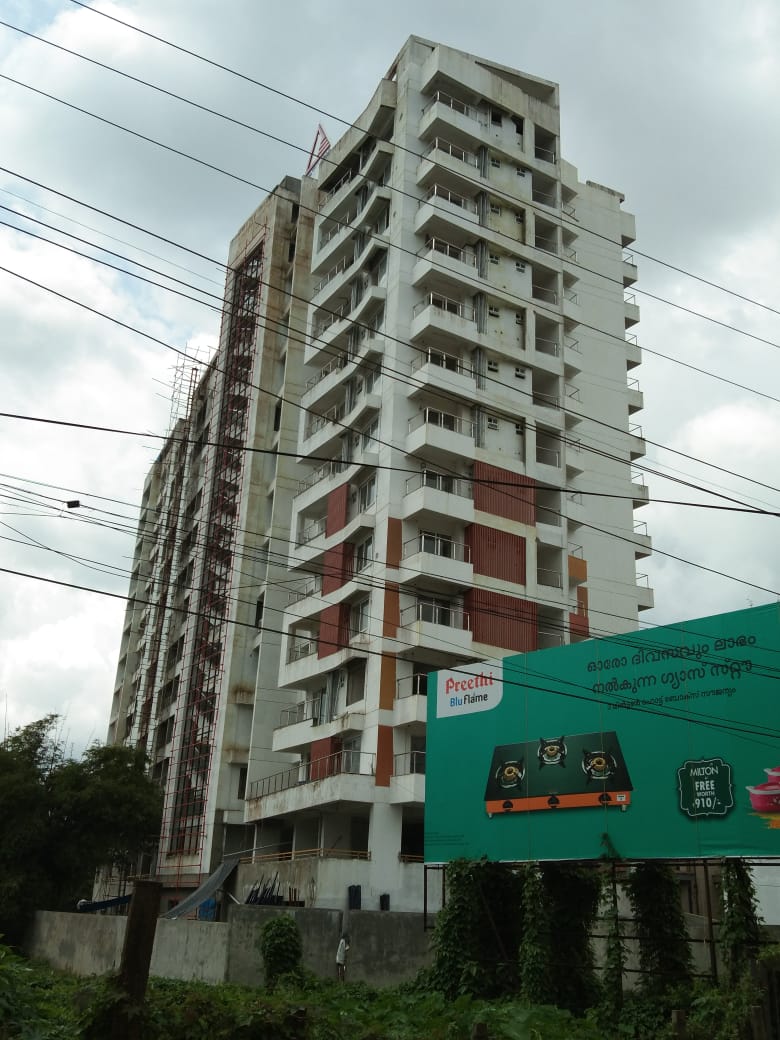

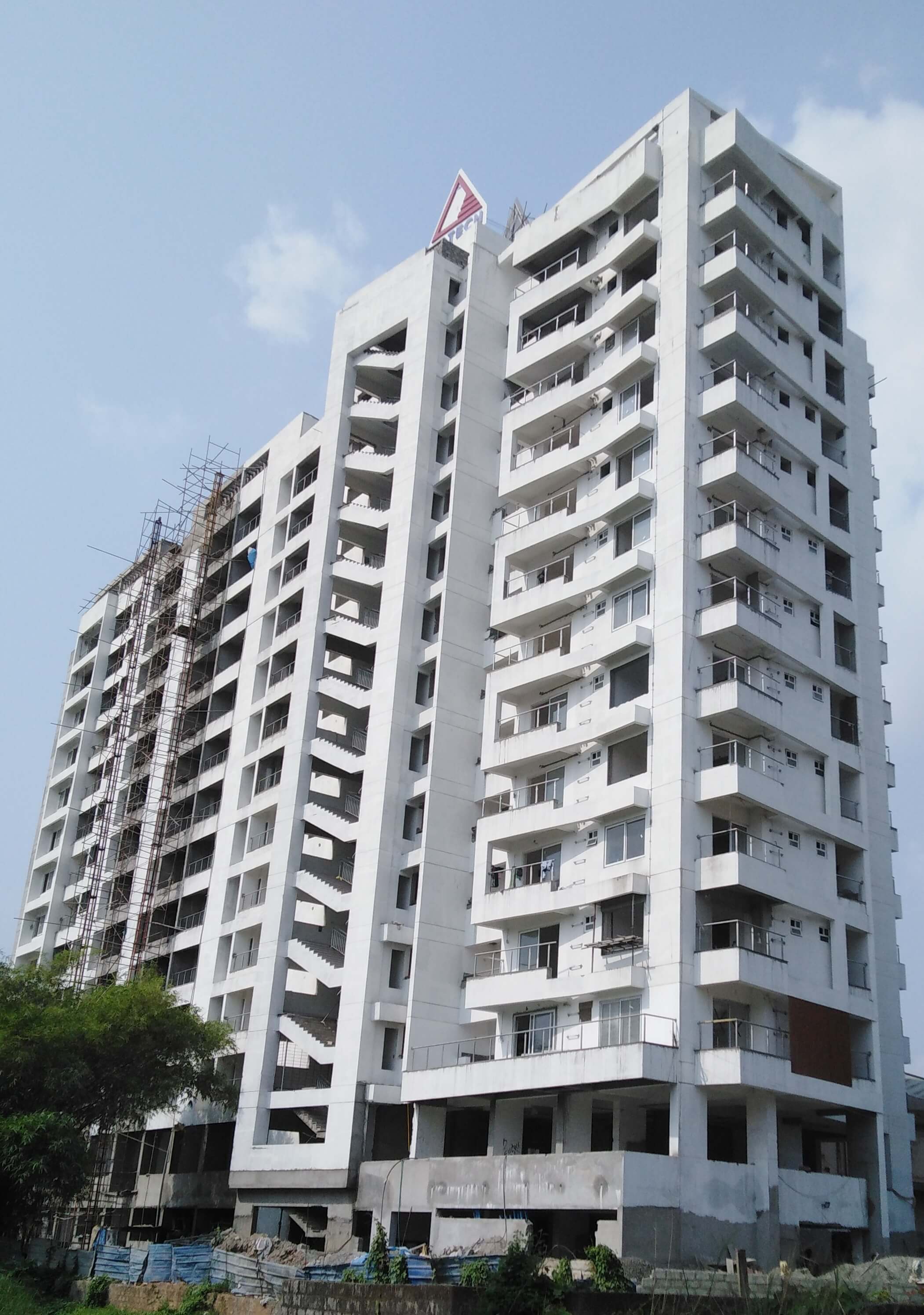

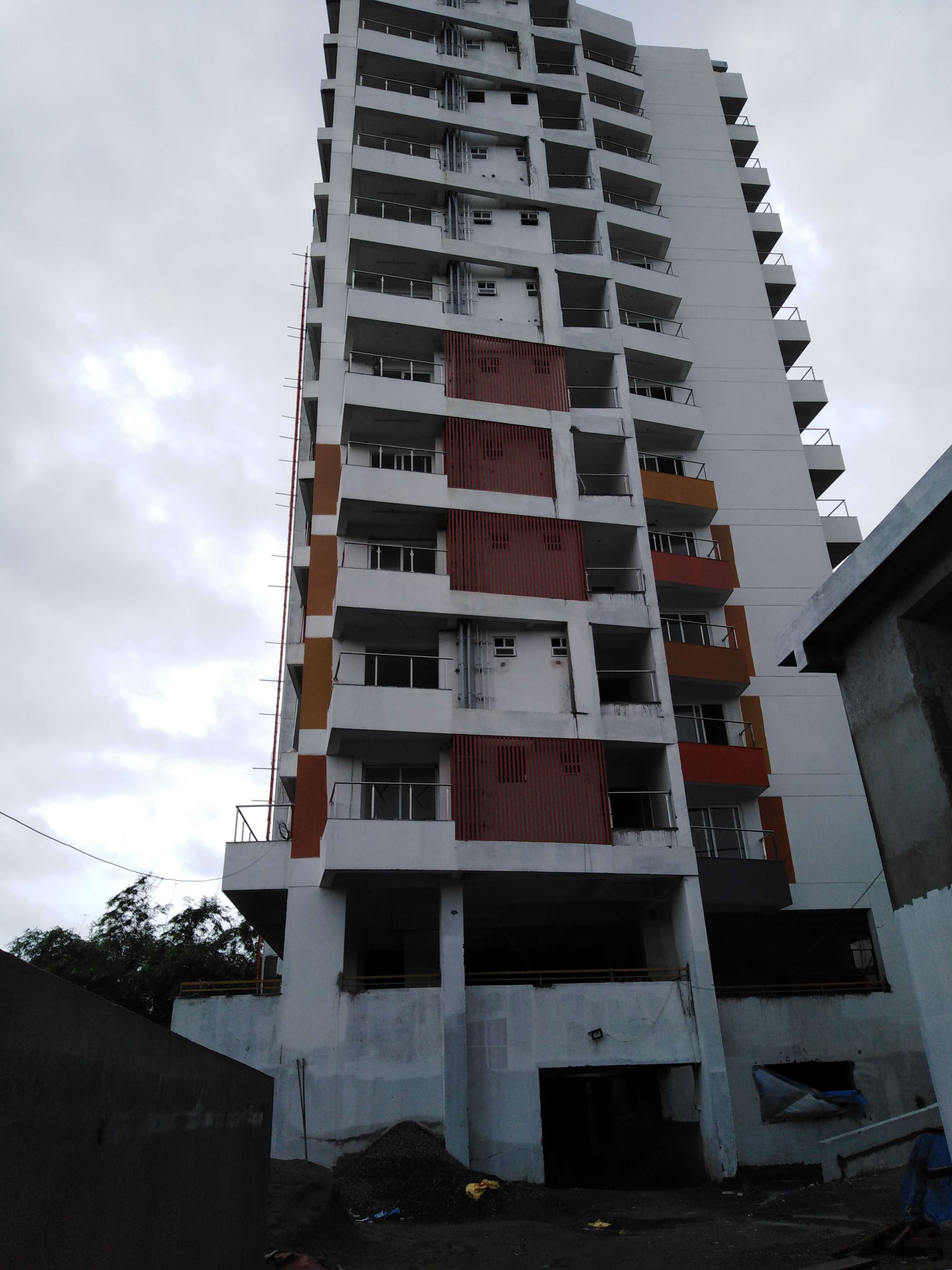

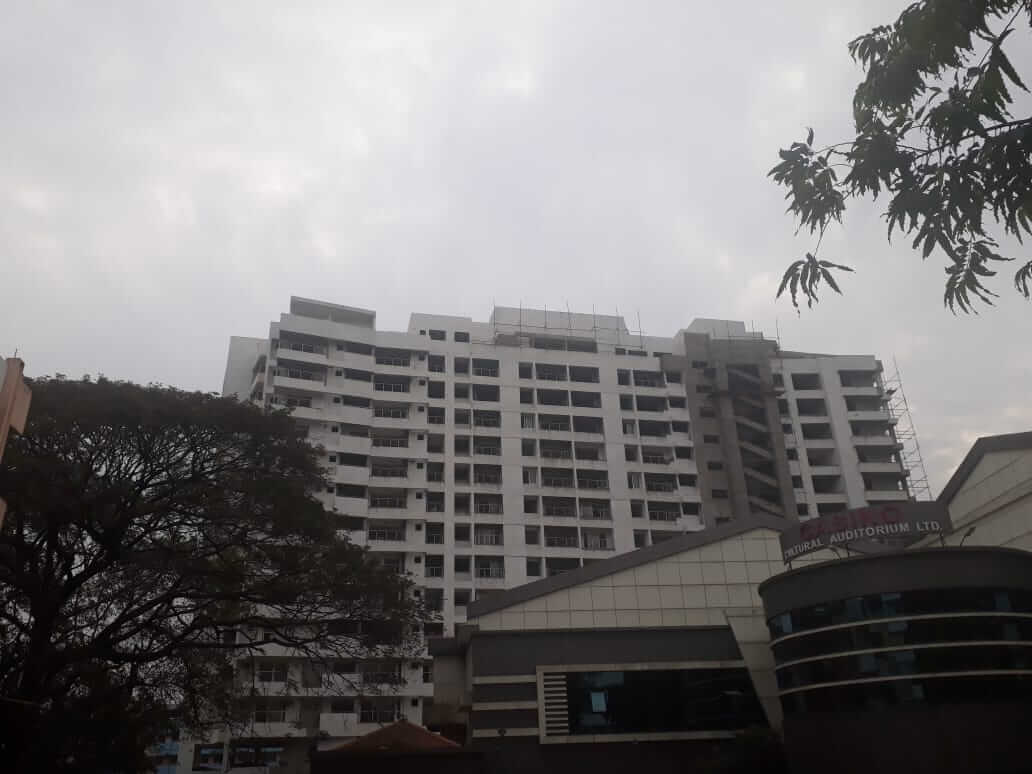

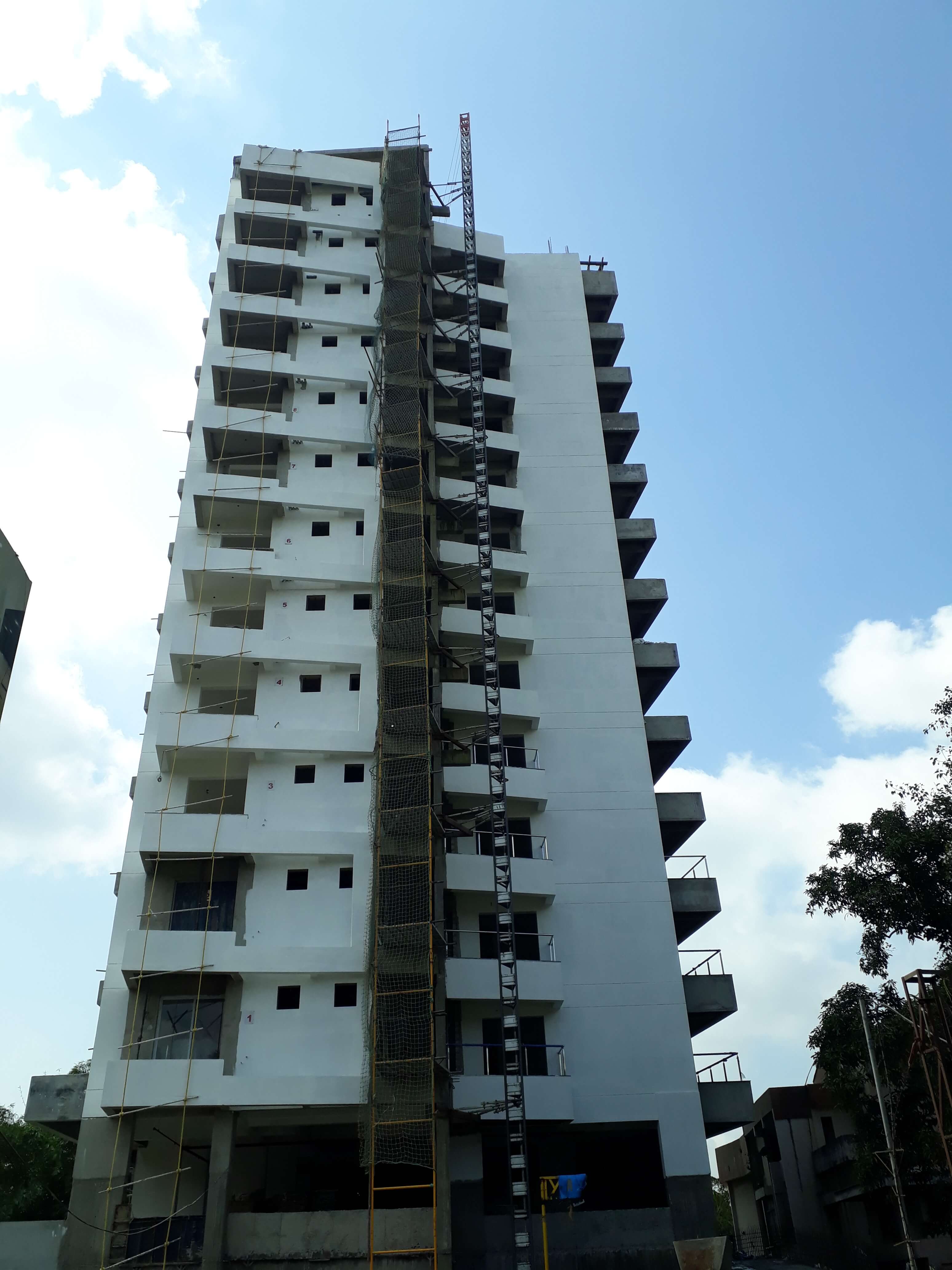

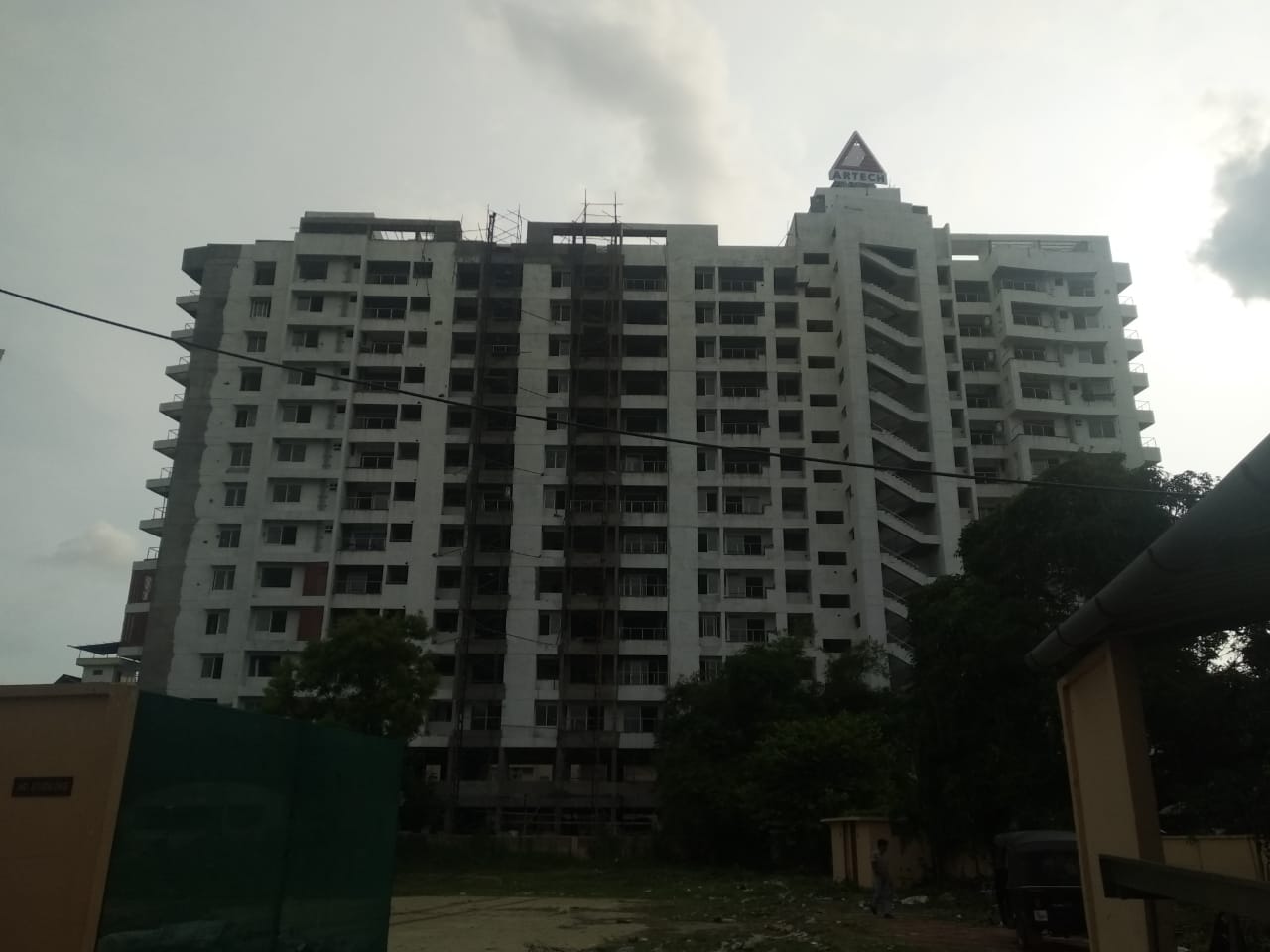

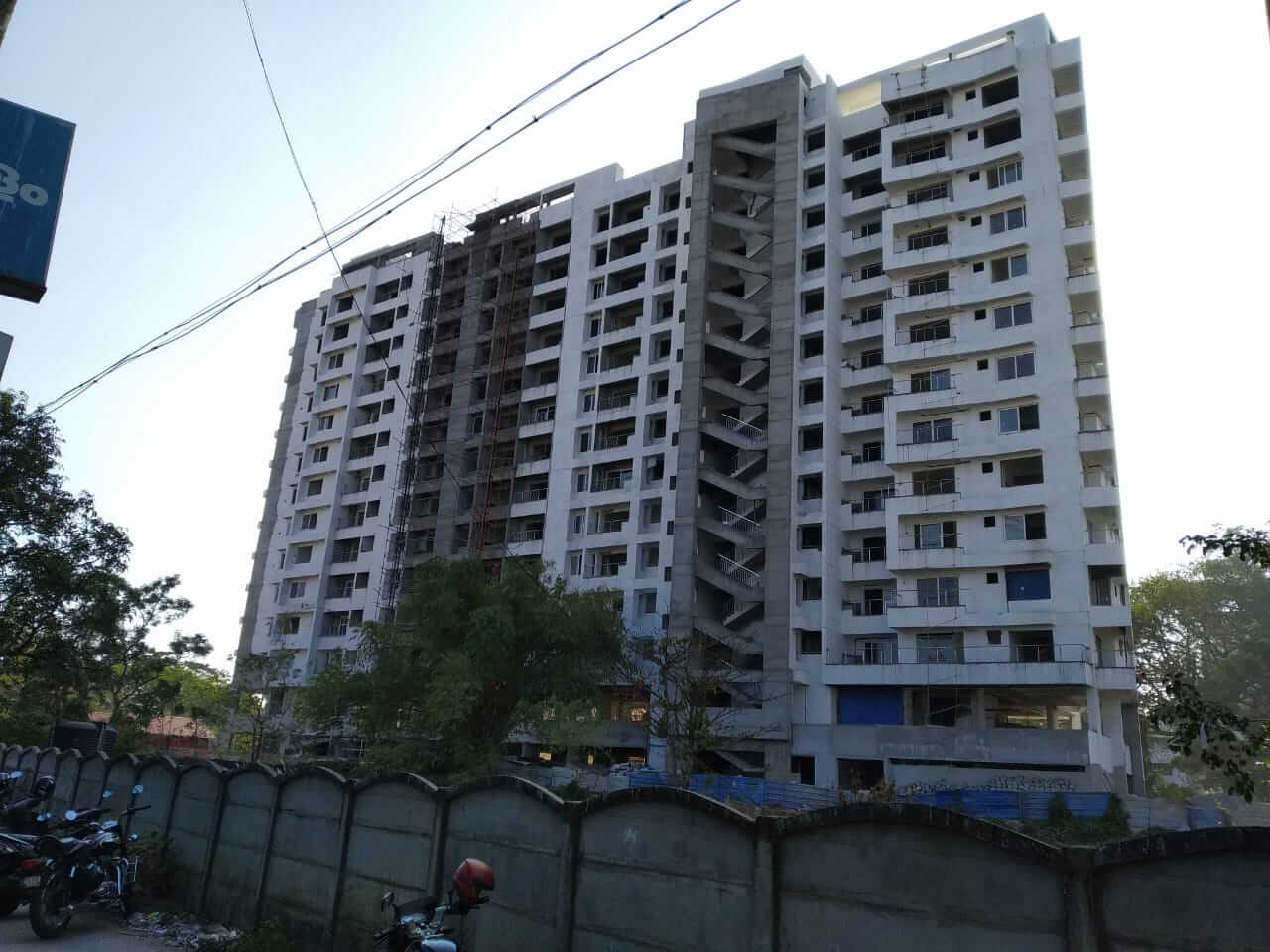

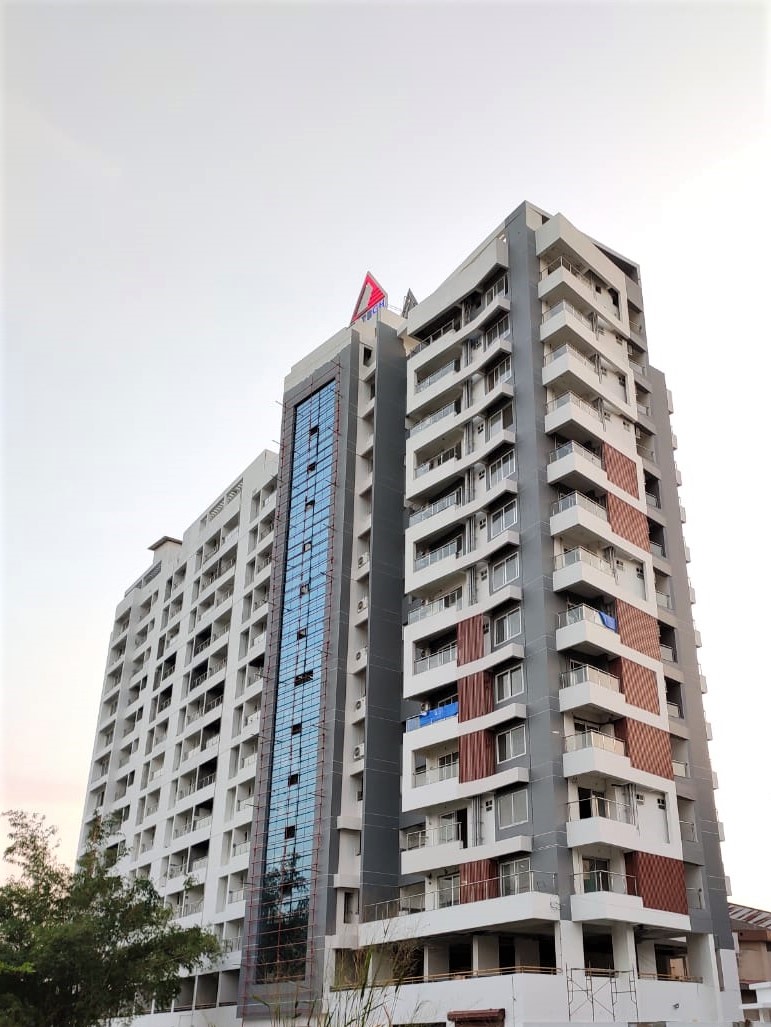

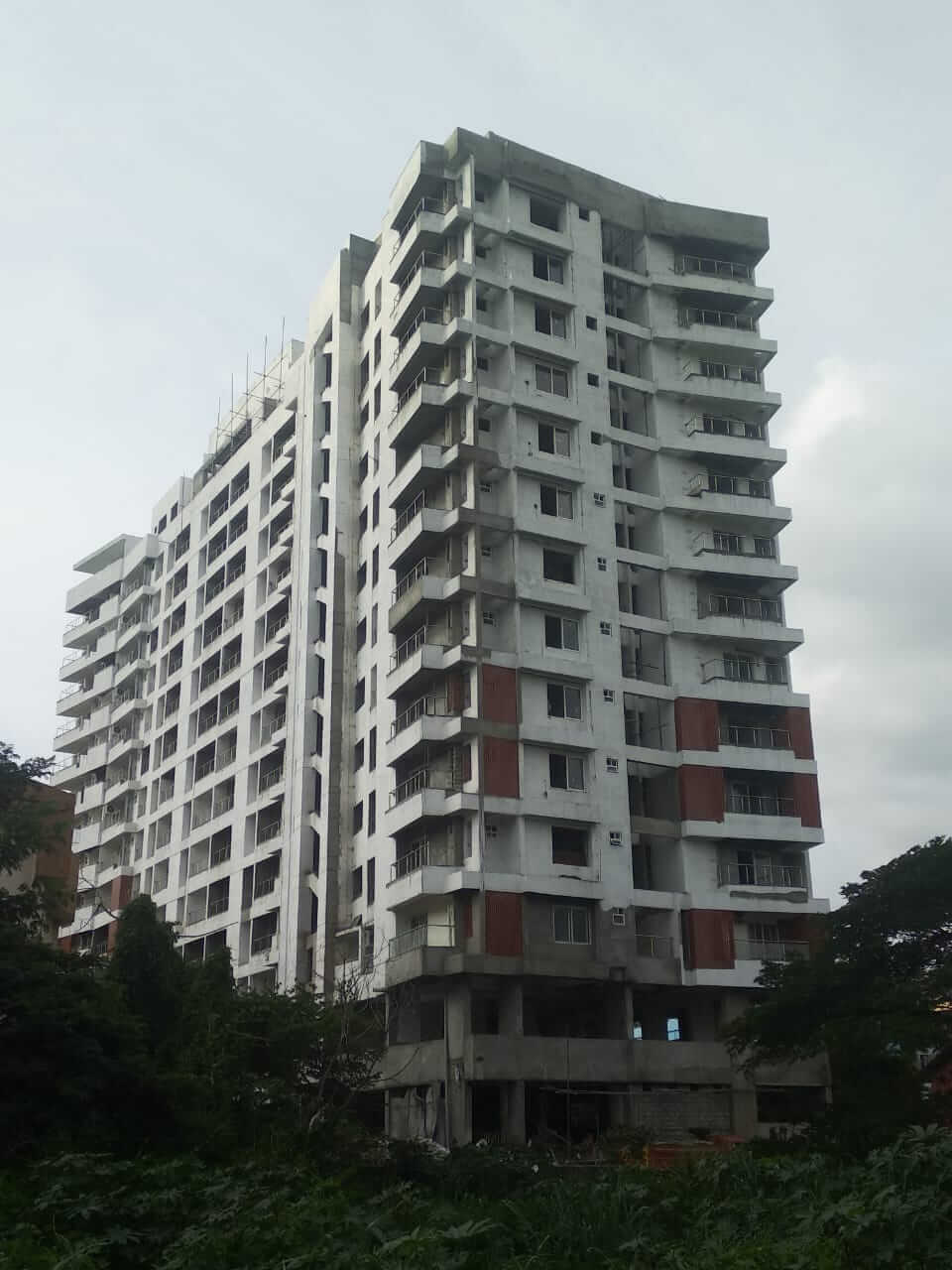

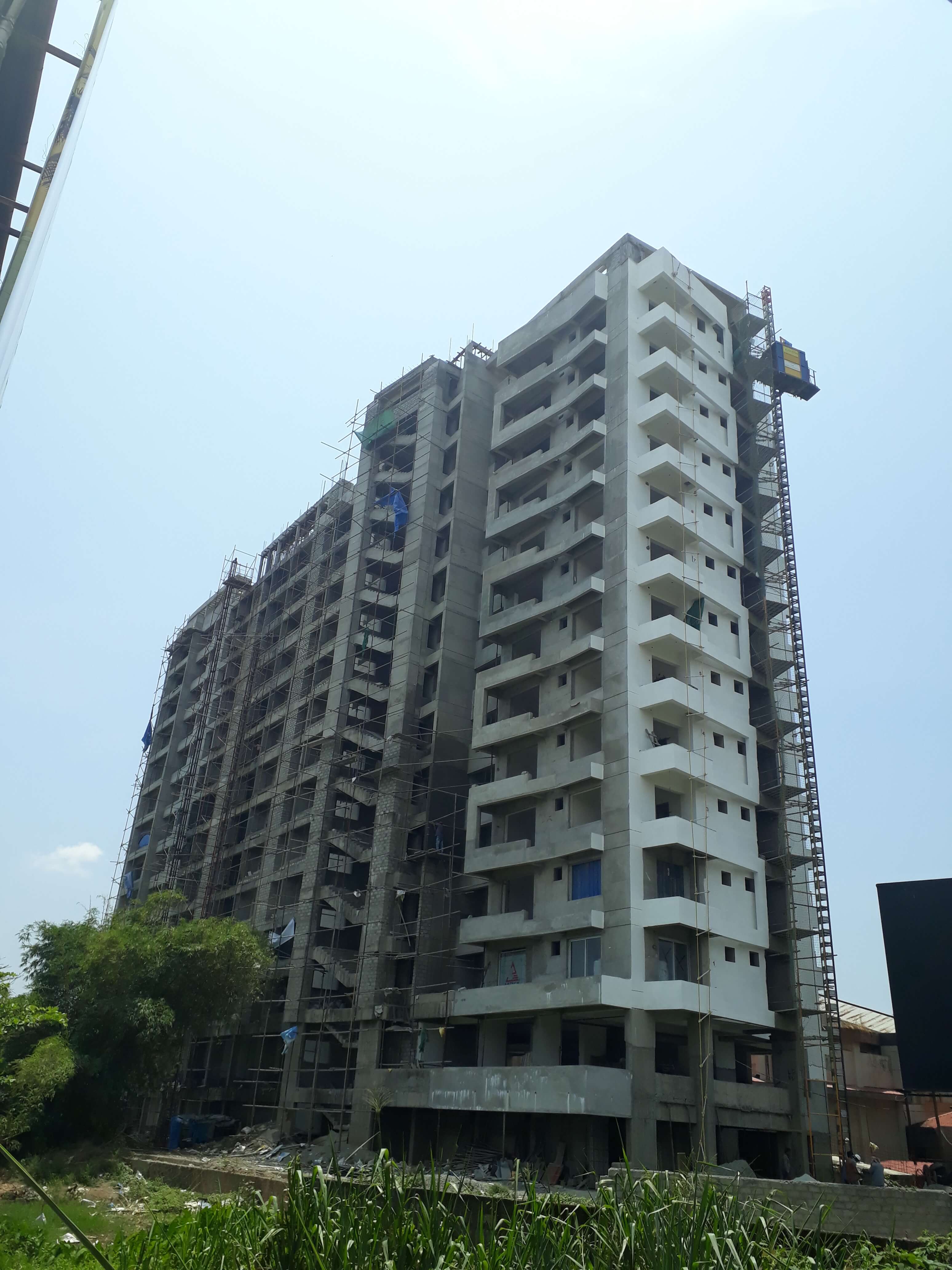

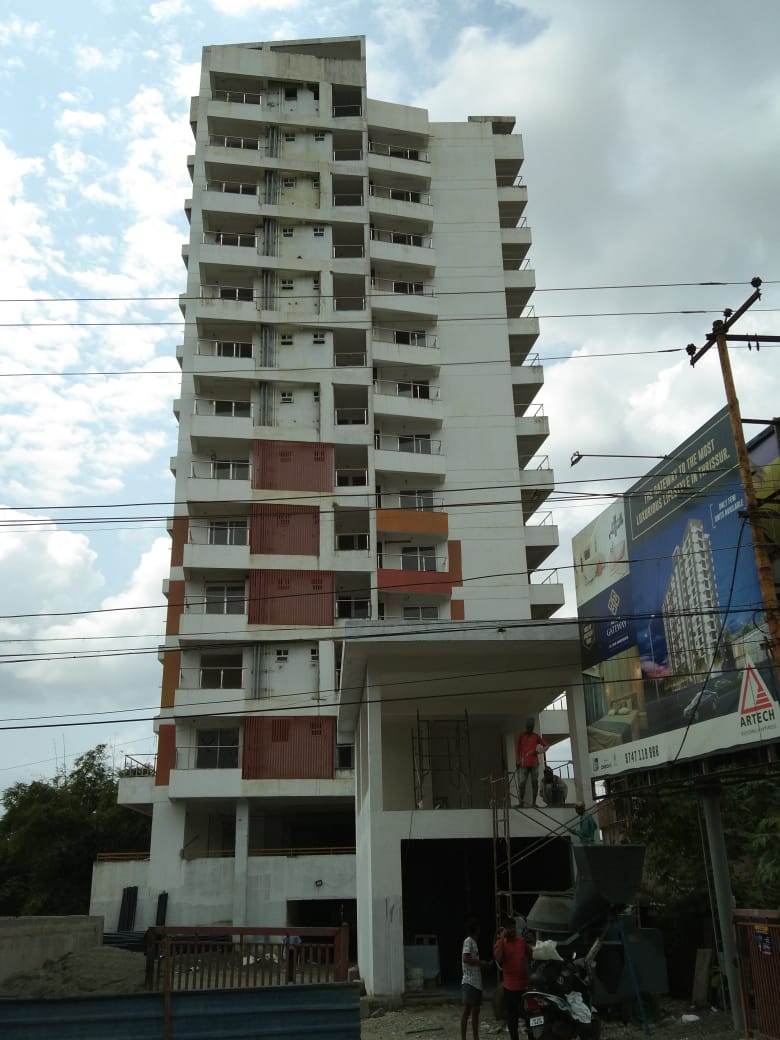

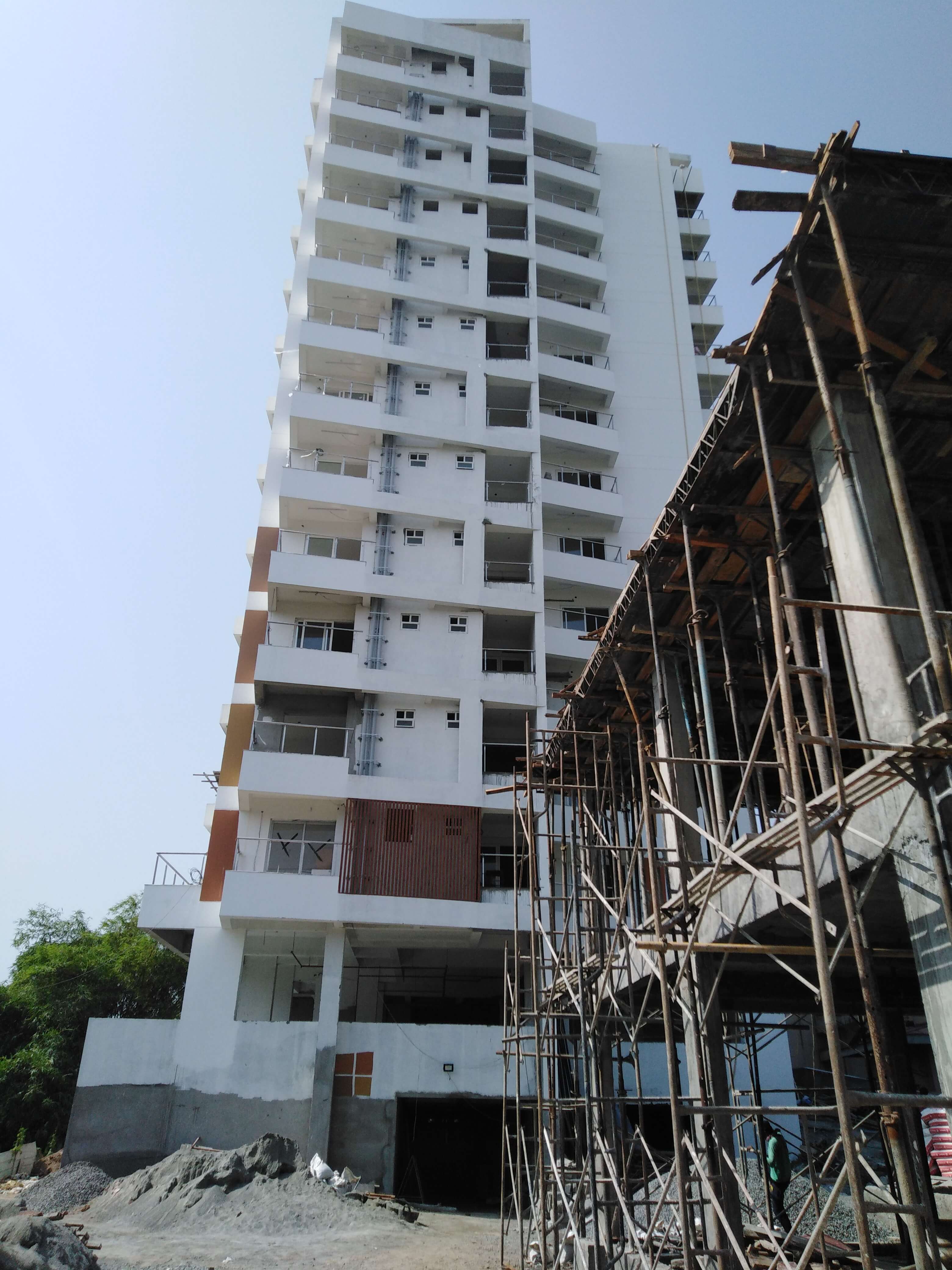

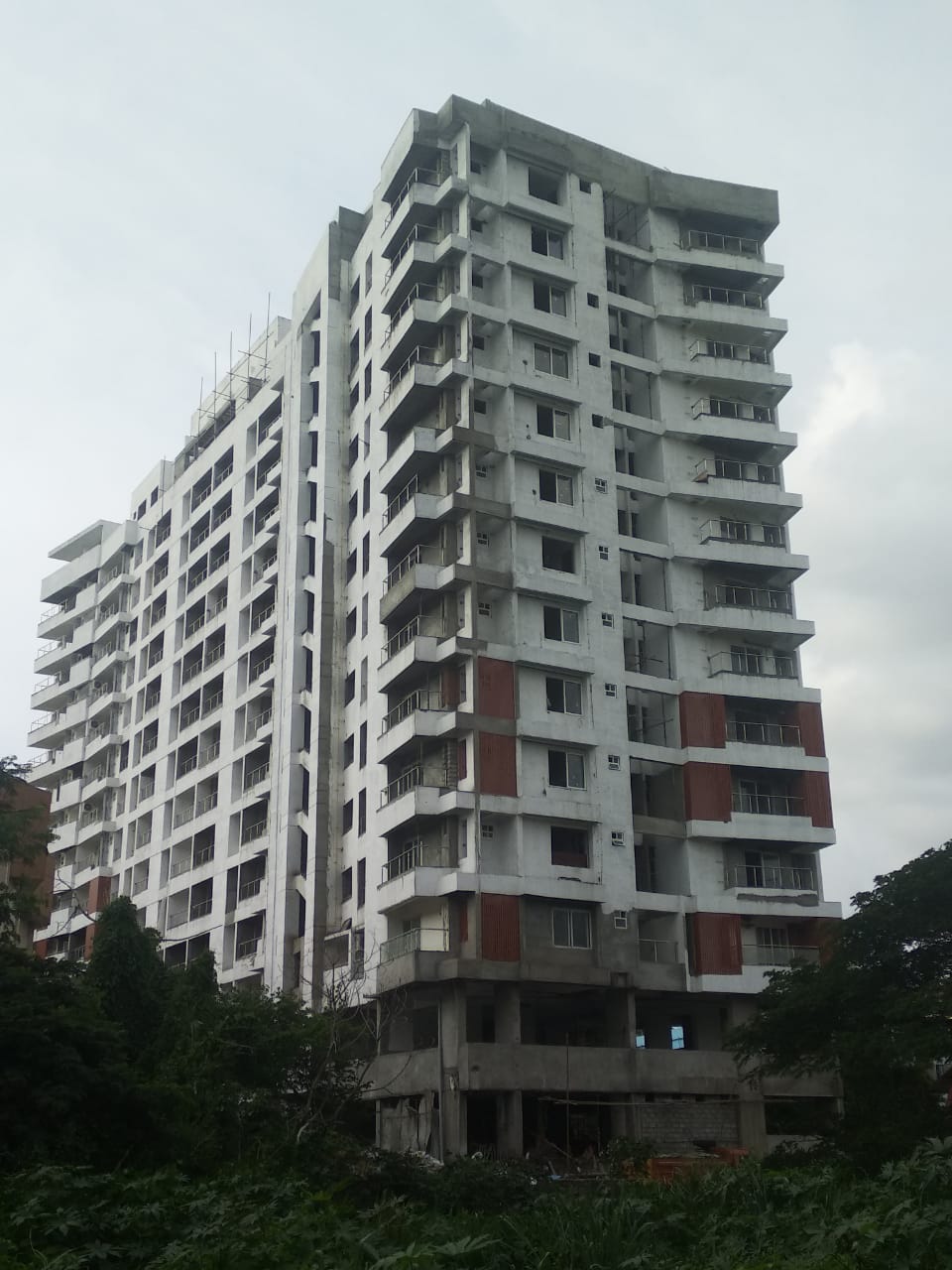

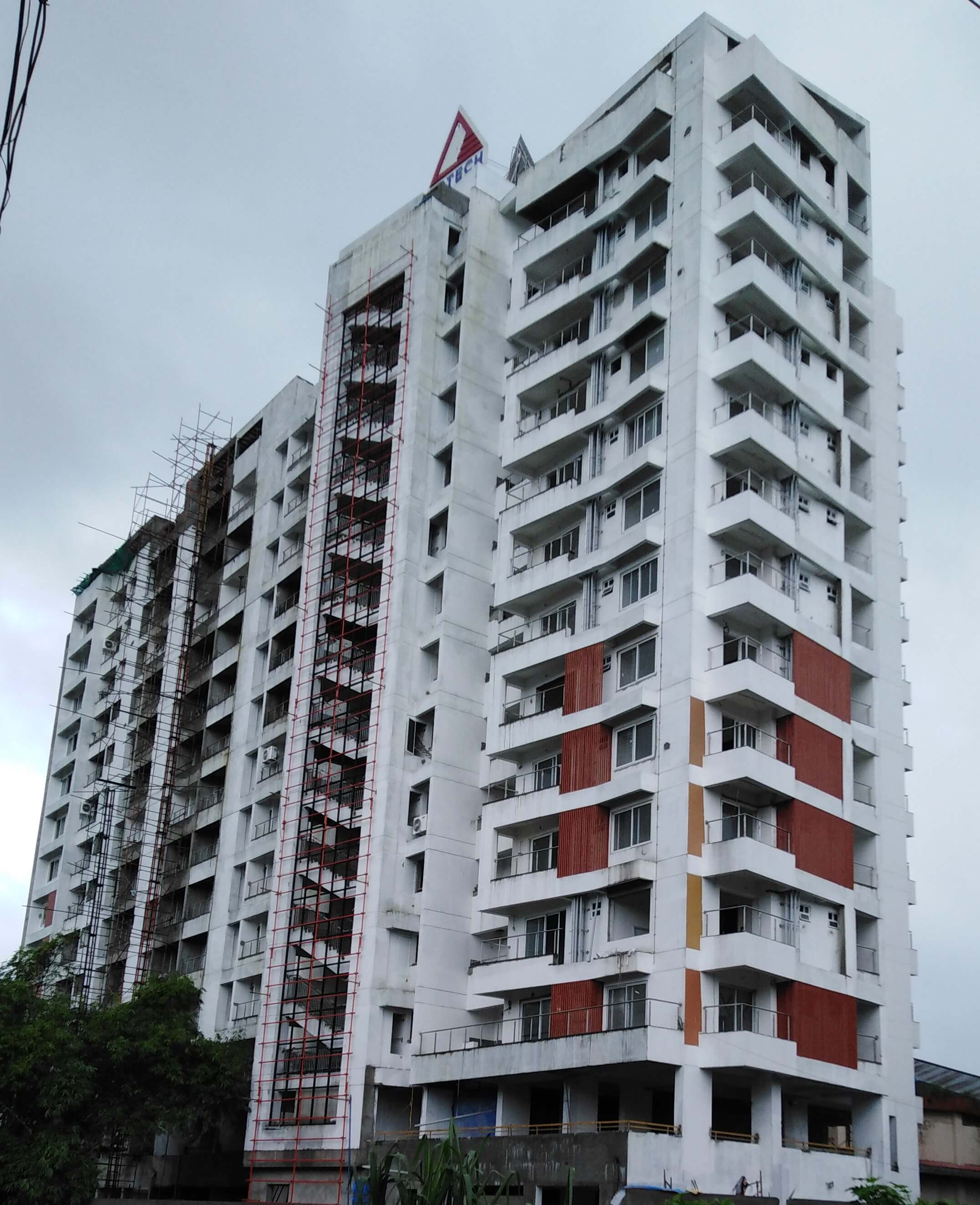

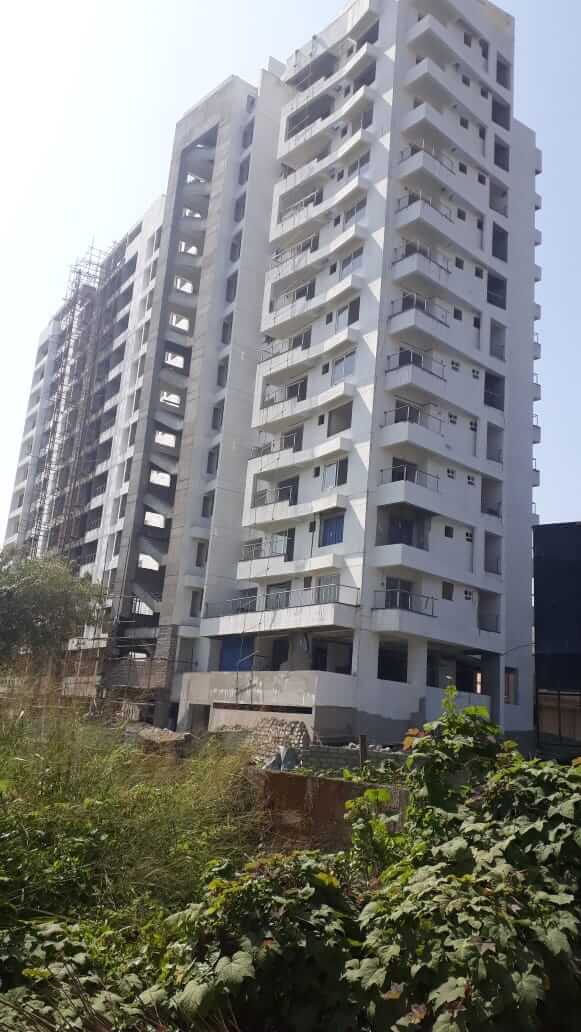

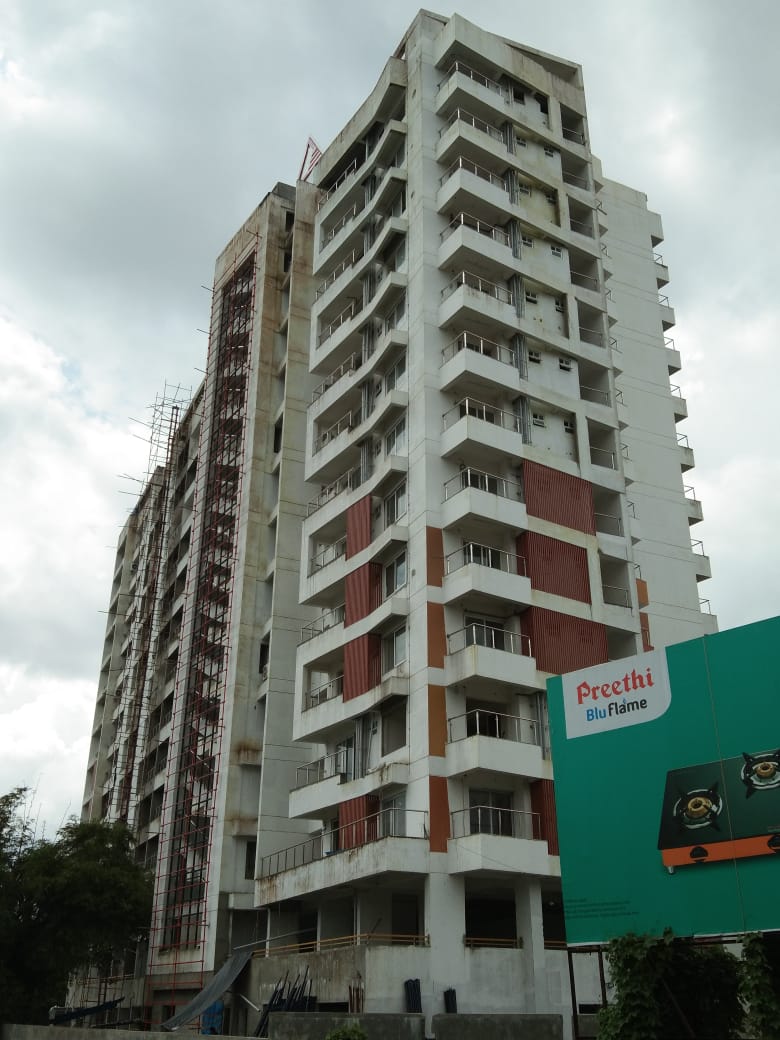

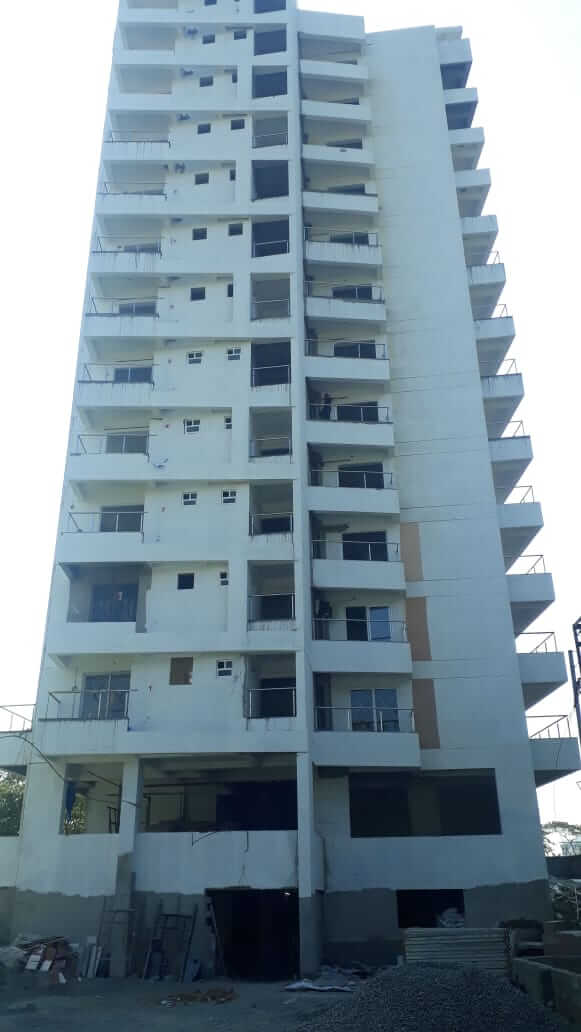

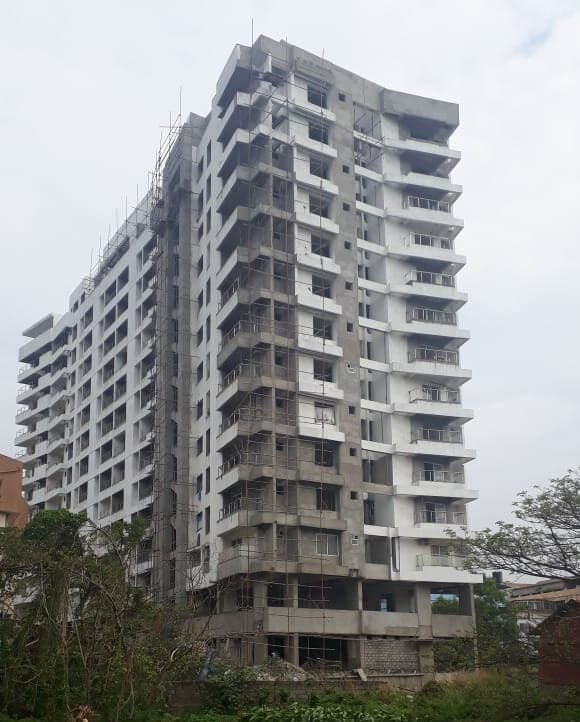

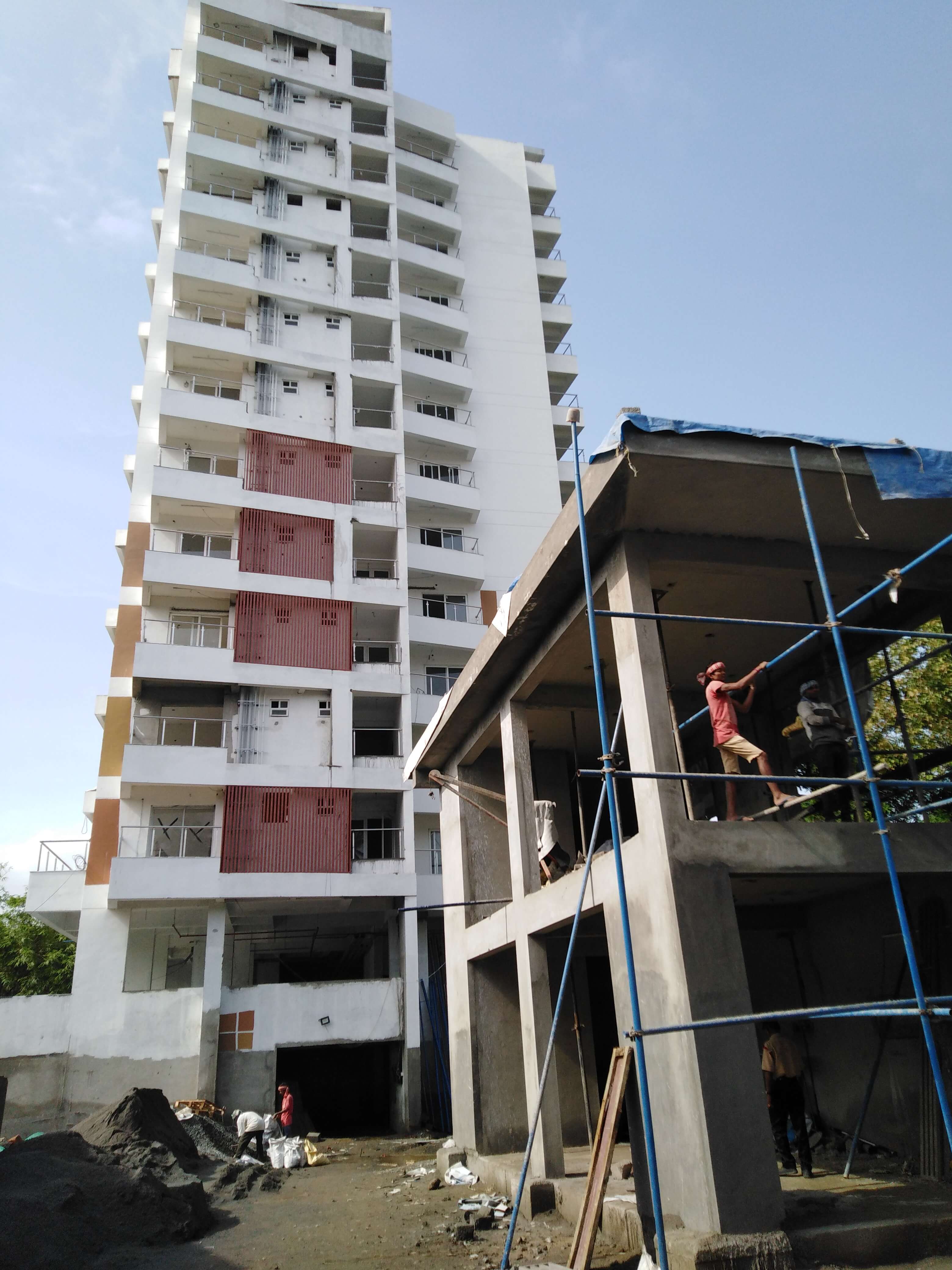

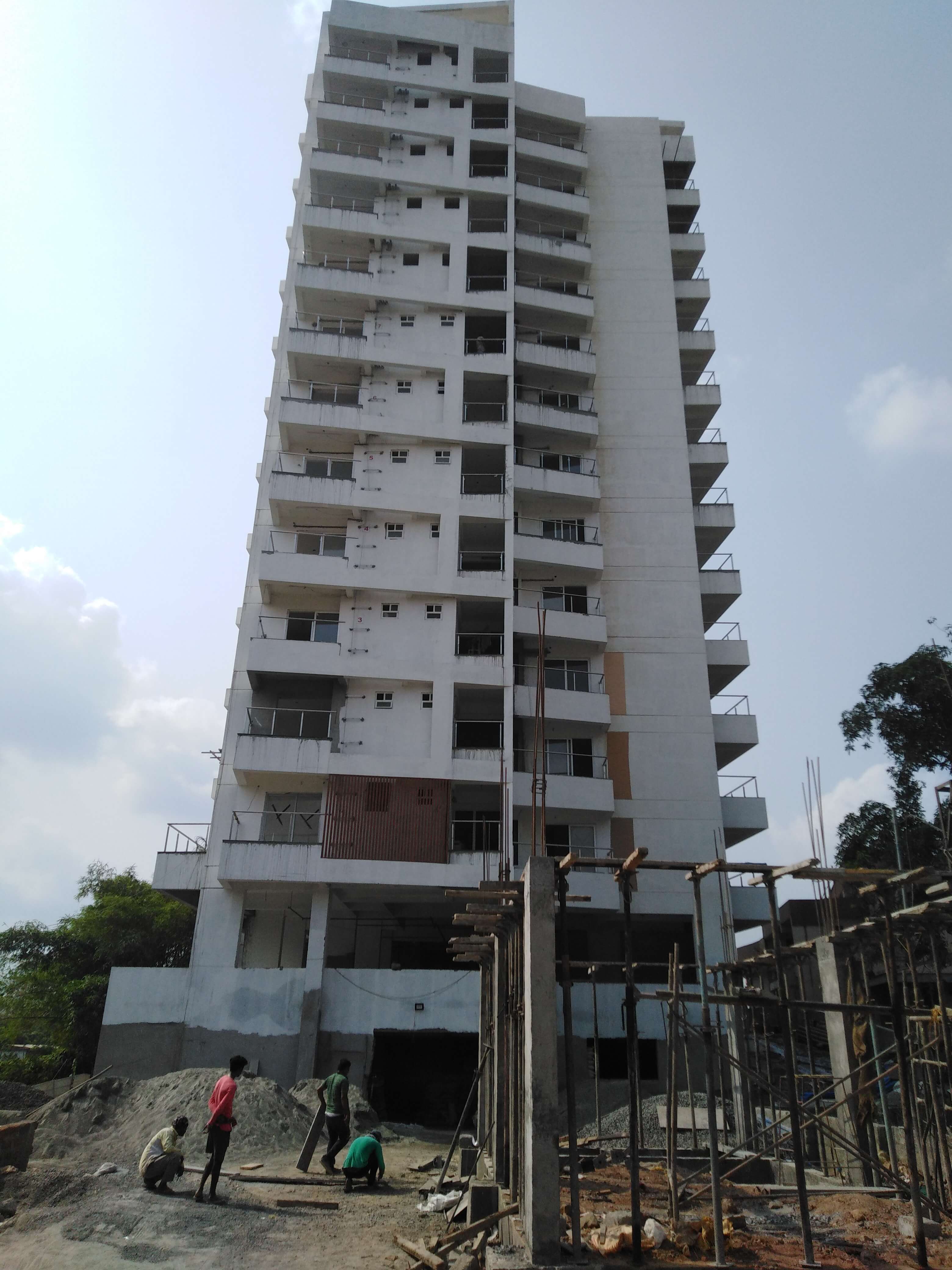

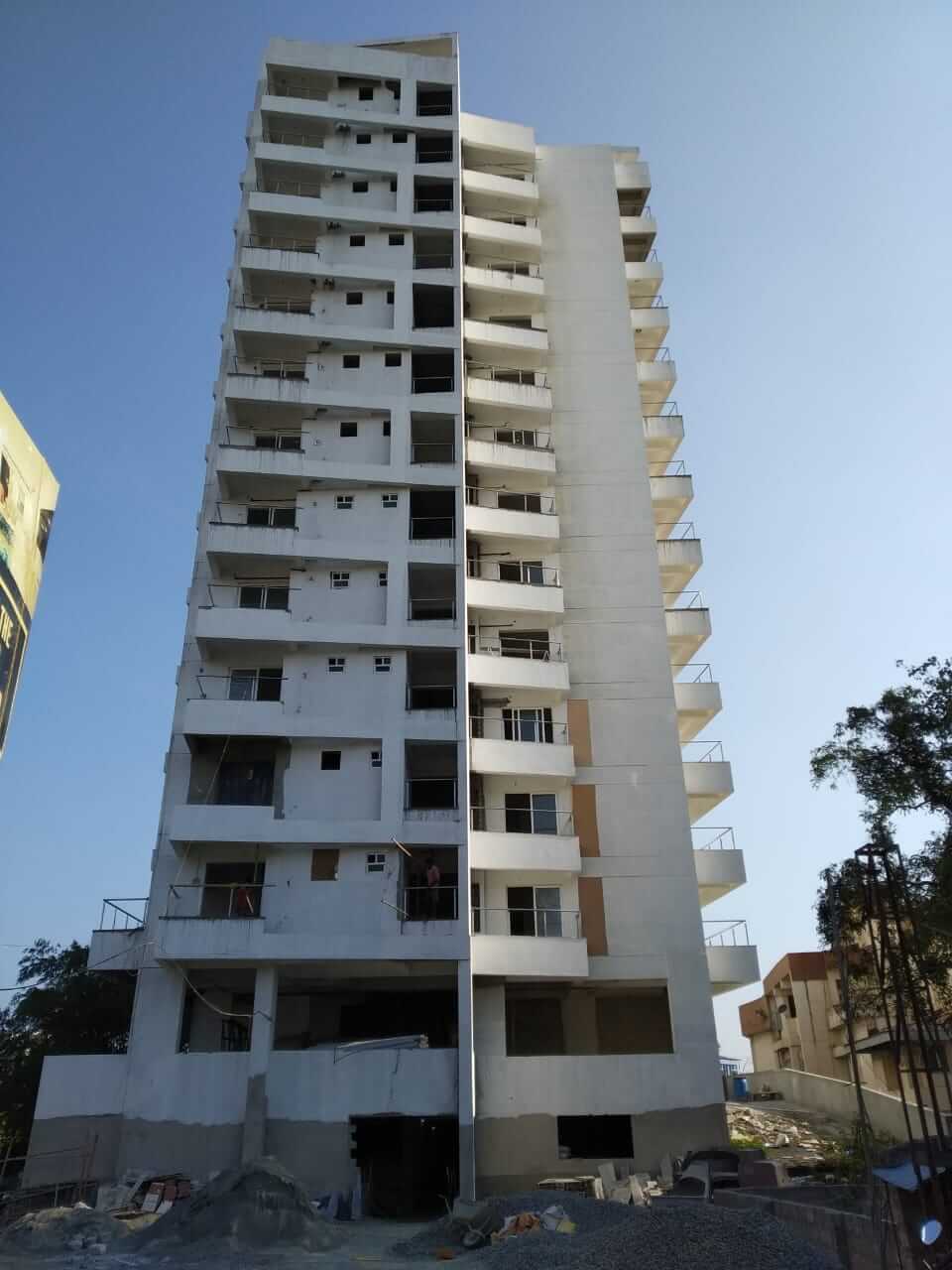

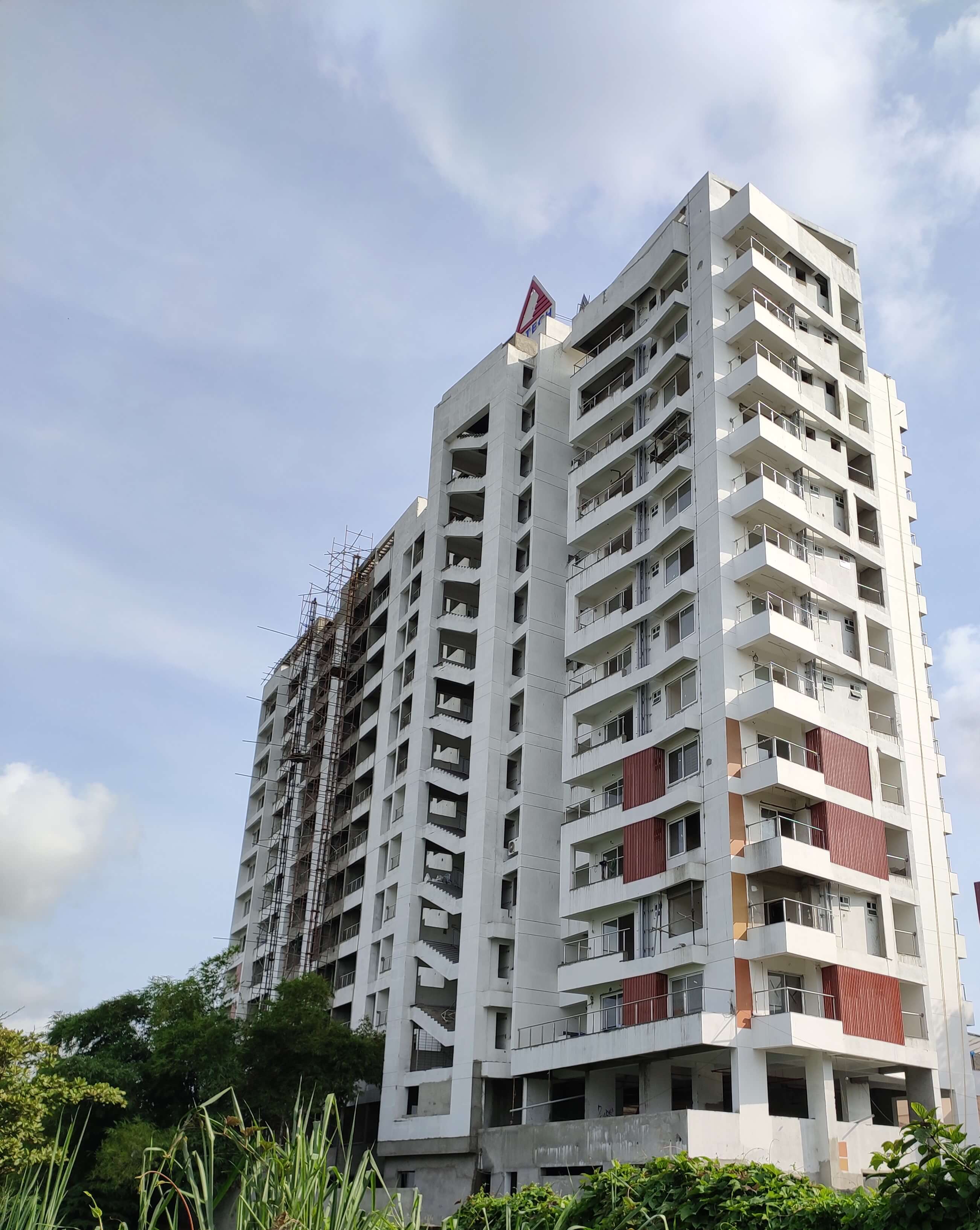

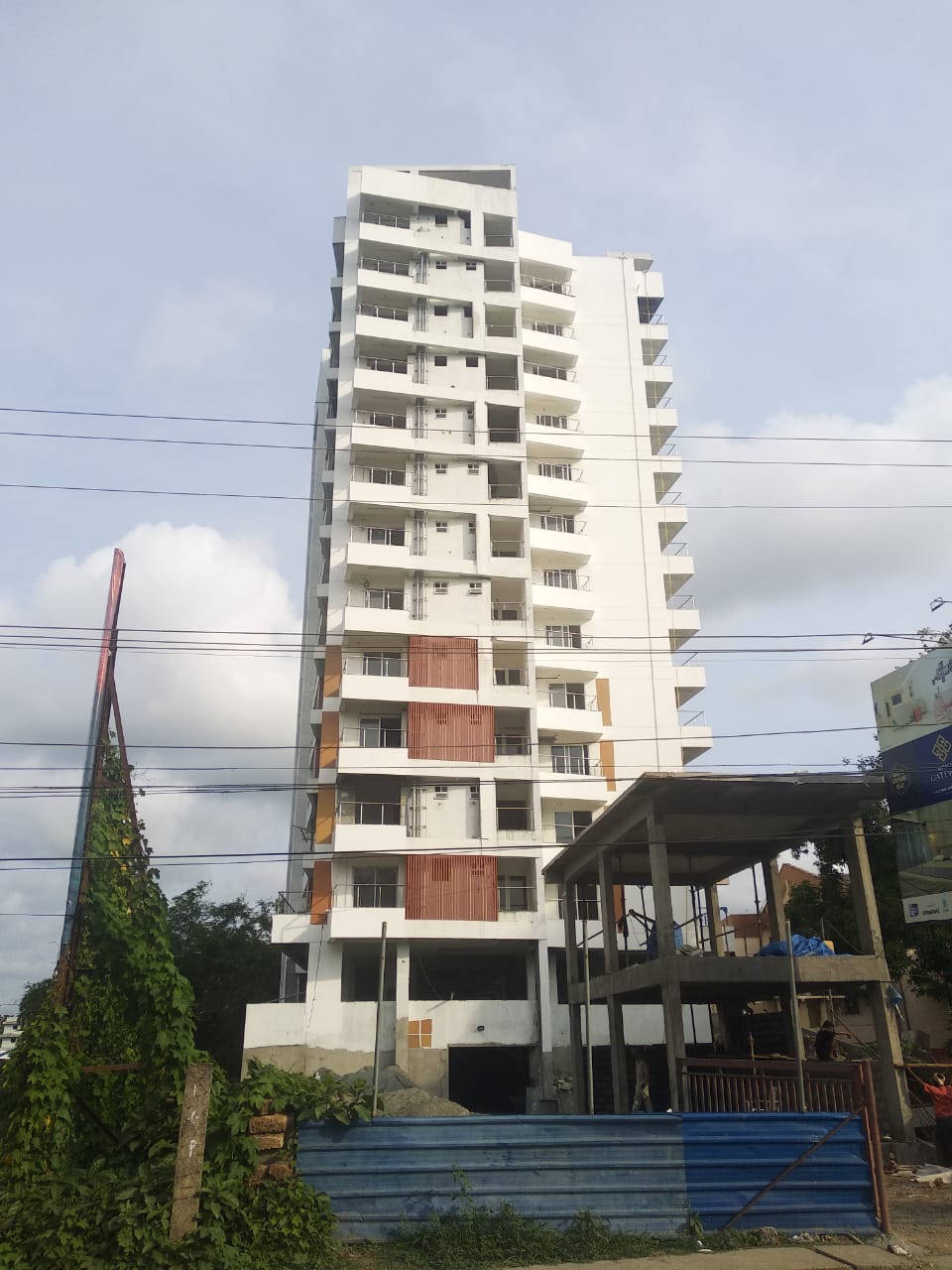

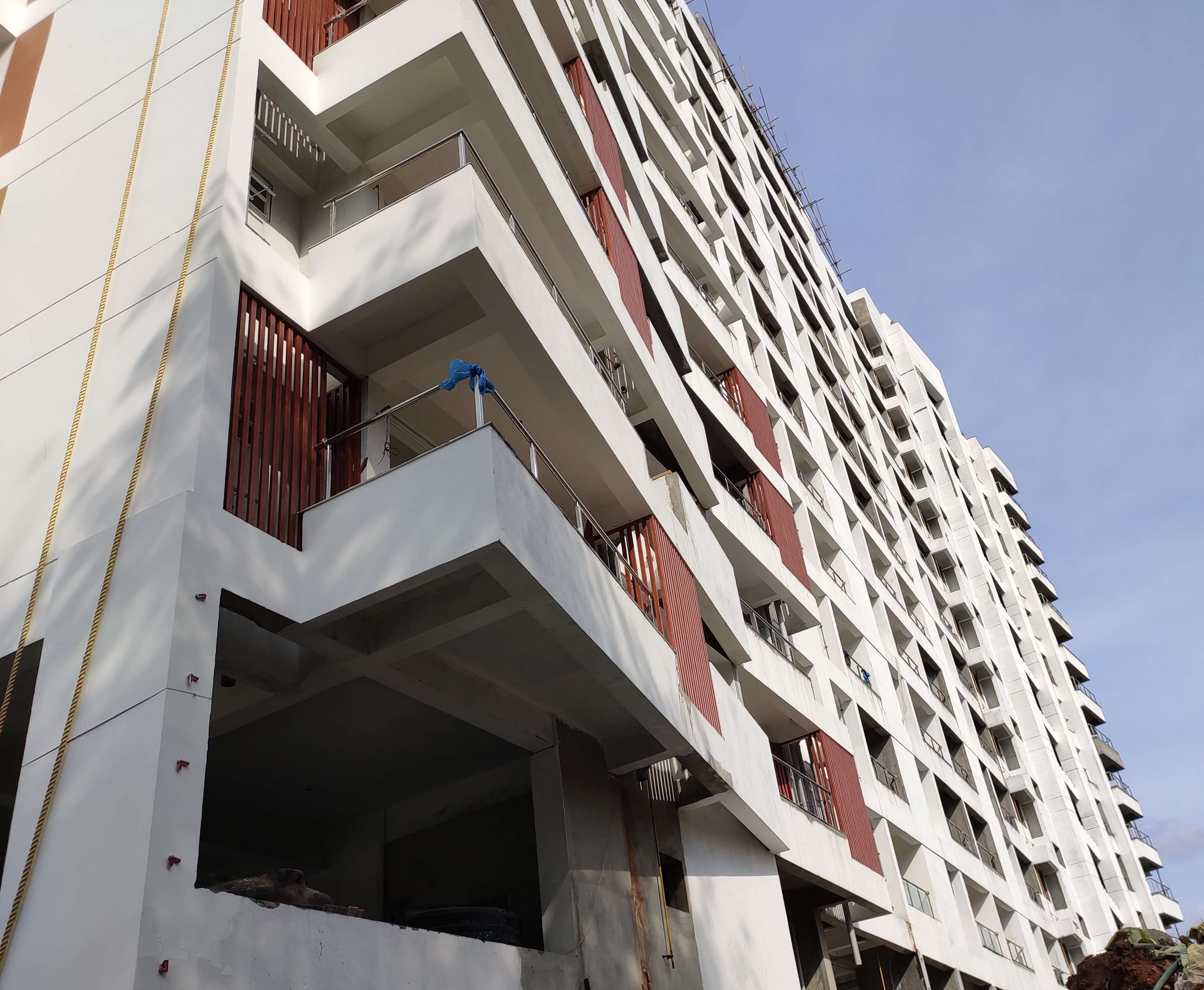

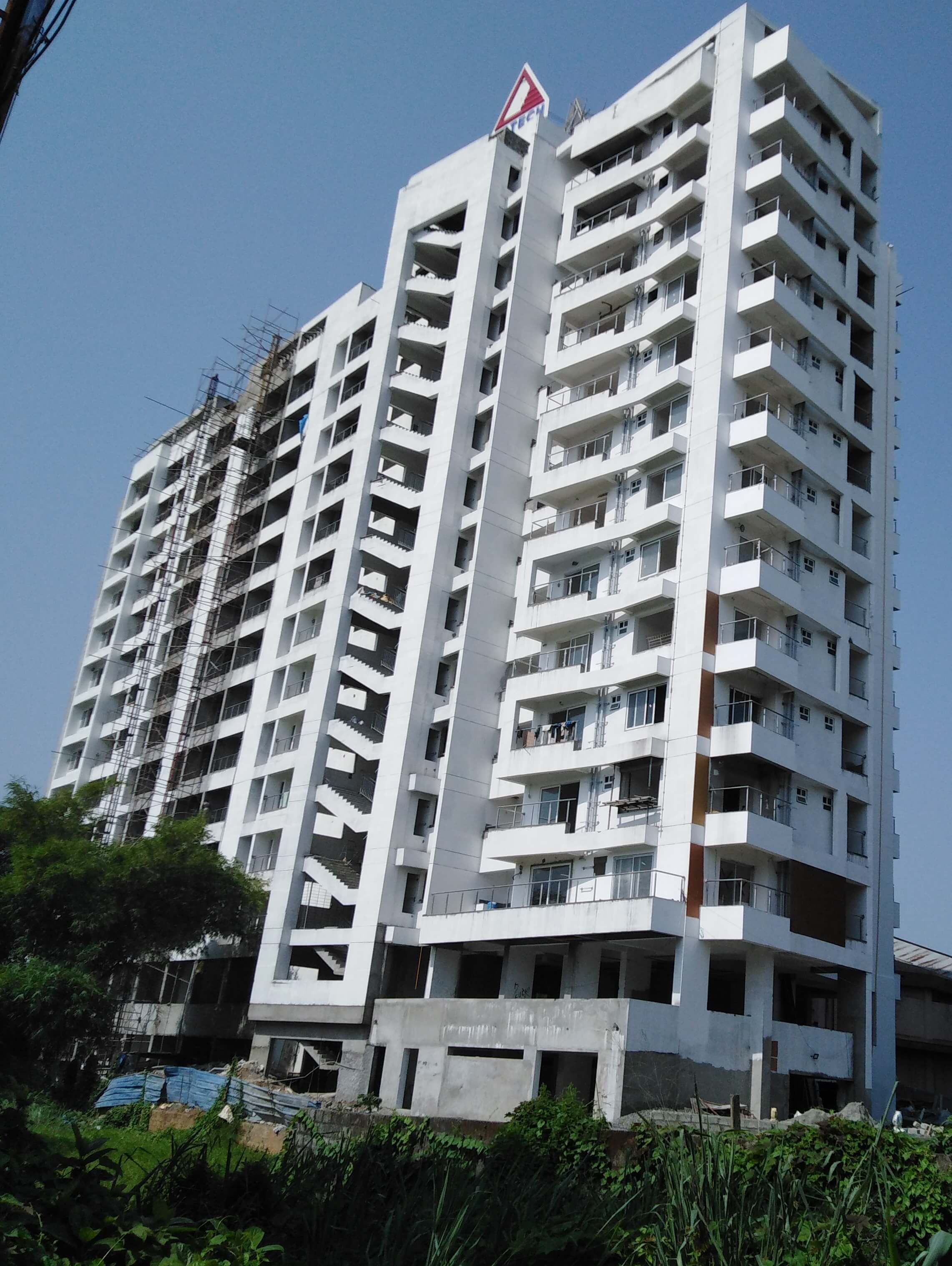

Artech Gateway - Progress

As per the current work status from our site we are targeted to complete the following works by end of February 2020

  • Wall Plastering work – BF1-100% to be completed.
  • Dadoing of toilets :BF1-100% to be completed, 12th floor- 100% to be completed.
  • Dadoing of Kitchen walls :4th floor – 12th floor:- 20% to be completed.
  • Inside Putty work (1st coat) – 100% to be completed
  • Second coat Painting :5 th -12th- 40 % to be completed.
  • Electrical wall chasing :BF1,13-100% to be completed
  • Wire Pulling :BF2,BF1,GF-100% to be completed. 13th floor :-100% to be completed.
  • Tiling work – 1st-13th floor (100%) to be completed
  • Plumbing : BF2-GF-100% to be completed.,13 th & 14th floor -100% to be completed
  • DB & Switch fixing :,4th,5th -20% to be completed , 6th to 12 th -30% to be completed.
  • CP sanitary fittings – 4th floor- 12th floor :-25% to be completed
  • Aluminium Fabrication work – BF-13 th floor -100% to be completed
  • HT Electrical work-70% to be completed
  • Balcony Handrail work -(1-12 th )80% to be completed
  • Door Shutter fixing :1st-13th -100% to be completed.
  • Flooring & Skirting :100% to be completed
  • Final pointing & cleaning : 5th -12th- 40 % to be completed

Work status as on 08.02.2020, we have completed the following

    • Retaining wall – 100% completed
    • Earth work Excavation -100% completed
    • Earth work & Back filling – 100% completed
    • RCC for Structure- 100% completed
    • Ceiling Plastering work – 100% completed
    • Block Masonry work – 100% completed
    • Wall Plastering work – GF,1st to 11th floor (100% completed); 12th floor-14th floor 100% completed; Amenity Block (100% completed)
    • External Plastering work – 100% completed
    • Dadoing of toilets :GF-13 th floor -100% completed, 12th floor- 90% completed.

  • Waterproofing -100% completed
  • Inside Putty work (1st coat) -BF2-100% completed, BF1-90% completed, 1 -12 th floor -95% completed, 13th floor-90% completed.
  • First coat painting :1st -12 th floor-100% completed
  • Second coat Painting :2nd,3rd floor-15% completed, 1st floor-30% completed,4th floor -10% completed, 5th floor- 10% completed, 6th floor-11th floor 20% completed., 12th floor 10% completed.
  • Electrical wall chasing :Bf1-90% completed,GF-12 th floor -100% completed,13 th floor -90% completed.14th floor- 100% completed.
  • Wire Pulling :BF2-90%,BF1-90%,GF-90% Completed ,1-12th -100% completed, 13 th -90% completed.
  • Tiling work – 1st-13th floor (95%) completed
  • Plumbing : BF2-GF-90% completed.1-12th floor-100% completed,13 th & 14th floor -90% completed
  • DB & Switch fixing :1-40%,(,4th,5th )-10% ,6th to 12 th -30% completed.
  • CP sanitary fittings -FF-30%, 4th floor :-20% completed, 5-9 th-20%,11 th -20%,12 th -10% completed.
  • Aluminium Fabrication work – 1-12 th floor -90% completed
  • HT Electrical work-60% completed
  • Reticulated Gas Work-40% completed
  • Fire Work -100%completed
  • Balcony Handrail work -(1-12 th )100% completed
  • Door Shutter fixing :1st-9 th -80% completed, 10th-12th -70% completed.
  • Flooring & Skirting :95% completed
  • Final pointing & cleaning :
  • Lift work -100%completed
  • Landscaping work -80% completed
  • Amenity Block : 100% completed

As per the current work status from our site we are targeted to complete the following works by end of September 2019

  • Wall Plastering work – 12th floor (100% to be completed); Amenity Block (100% completed)
  • Dadoing of toilets :12th-13th-100% to be completed
  • Dadoing of Kitchen walls :4th to 12 th floor -10% to be completed
  • Water proofing -13-14 th floor-100% to be completed.
  • Inside Putty work (1st coat) -11 th ,12 th -100% to be completed,13 th -50% to be completed
  • First coat painting :1ST -12 th floor-90% to be completed
  • Second coat Painting :5 th -10%,6 th -30%,7-12 th -20% tobe completed.
  • Wire Pulling -BF2,BF1,GF -100% to be completed
  • Tiling work – 10-13 th floor -95% to be completed
  • Plumbing : GF-100% to be completed .
  • DB & Switch fixing :(,4th,5th )-20% to be comlpleted
  • cp sanitary fittings -4th -9 th floor-25% to be completed
  • Aluminium Fabrication work – 1-12 th -100% to be completed.
  • HT Electrical work-70% to be completed
  • Water proofing -terrace area water proofing -100% to be completed .
  • Fire Work -90% to be completed
  • Balcony Handrail work -(1-12 th )80% to be completed .
  • Door Shutter fixing :1-12 th floor -80% completed
  • Lift work -90% to be completed
  • Amenity Block :,electrical chasing -100%,plumbing -80%,wall plastering -100%, dadoing of toilets -100%,wire pulling -100%,Toilet water proofing -100% completed,flooring and skirting -95% to be completed

Work status as on 05.09.2019, we have completed the following

  • Retaining wall – 100% completed
  • Earth work Excavation -100% completed
  • Earth work & Back filling – 100% completed
  • RCC for Structure- 100% completed
  • Ceiling Plastering work – 100% completed
  • Block Masonry work – 100% completed
  • Wall Plastering work – GF,1st to 11th floor (100% completed); 12th floor (95% completed); Amenity Block (100% completed)
  • External Plastering work – 100% completed
  • Dadoing of toilets :1st -10thfloor -100% completed,,11-12th-13 th floor -90% completed
  • Dadoing of Kitchen walls :1st floor -100% completed
  • Water proofing -(1-12 th floor )100%completed,13 th floor 70% completed,14 th floor -80% completed.
  • Inside Putty work (1st coat) – 1-100% ,2st to 9th floor (90% completed),11 th ,12 th -90% completed
  • First coat painting :1ST -12 th floor-70% completed
  • Second coat Painting :1st floor -30% completed
  • Door frame fixing -100%completed
  • Electrical wall chasing :Bf1-70% completed,GF-12 th floor -100% completed,13 th floor -90% completed.
  • Wire Pulling :BF2-GF-30% Completed ,1-11th -100% completed,12 th -90%,13 th -50% completed.
  • Tiling work – 1st-9 th floor (95% completed); ,10 th floor -12 th floor -90%,13 th floor -60% completed
  • Plumbing : 1-12th floor-100% -completed,13 th floor -70% completed
  • DB & Switch fixing :1-40%,(,4th,5th )-10% ,6th to 12 th -30% completed.
  • cp sanitary fittings -FF-30% completed,4 th -10%,6-7 th -20% completed
  • Aluminium Fabrication work – 1-12 th floor -80% completed
  • HT Electrical work-60% completed
  • Reticulated Gas Work-40% completed
  • Water proofing -(1-10 th floor )100%completed,11 th ,12thfloor -100% completed ,terrace area water proofing -40% completed .
  • Fire Work -80% completed
  • Balcony Handrail work -(1-12 th )70% completed
  • Door Shutter fixing :1-80%,2–9th -70%completed,10 th –12 th floor 50% completed.
  • Lift work -70%completed
  • Amenity Block :RCC For super structure,block masonry-100%.ceiling plastering :100% ,doorframe fixing -90%,electrical chasing -90%,plumbing -70%,wall plastering -100%, dadoing of toilets -70%,wire pulling -100%,Toilet water proofing -70% completed,flooring and skirting -60%. completed

As per the current work status from our site we are targeted to complete the following works by end of August 2019

  • Dadoing of toilets :12th-13th-100% to be completed
  • Dadoing of Kitchen walls :5 th to 7 th floor -10% to be completed
  • Water proofing -13-14 th floor-100% to be completed.
  • Inside Putty work (1st coat) -11 th ,12 th -100% to be completed
  • Second coat Painting :5 th -10%,6 th -30%,7-12 th -20% tobe completed.
  • Wire Pulling -13 th floor -100% to be completed.
  • Tiling work – 10-13 th floor -95% to be completed
  • Plumbing : GF& 13 th floor -80% to be completed
  • DB & Switch fixing :(,4th,5th )-20%,(6-12 th )-30% to be completed.
  • cp sanitary fittings -4th -9 th floor-25% to be completed
  • Aluminium Fabrication work – 1-12 th -100% to be completed.
  • HT Electrical work-70% to becompleted
  • Fire Work -90% to be completed
  • Balcony Handrail work -(1-12 th )60% to be completed.
  • Door Shutter fixing :2-9 th -75% completed,10-12 th -50% completed
  • Lift work -90% to be completed
  • Amenity Block :,electrical chasing -100%,plumbing -80%,wall plastering -100%, dadoing of toilets -100%,wire pulling -100%,Toilet water proofing -100% completed,flooring and skirting -95% to be completed

Work status as on 05.08.2019, we have completed the following

  • Retaining wall – 96% completed
  • Earth work Excavation – 99% completed
  • Earth work & Back filling – 90% completed
  • RCC for Structure- 100% completed
  • Ceiling Plastering work – 100% completed
  • Block Masonry work – 100% completed
  • Wall Plastering work – GF,1st to 11th floor (100% completed); 12th floor (95% completed); Amenity Block (100% completed)
  • External Plastering work – 100% completed
  • Dadoing of toilets :1st -10thfloor -100% completed,,11-12th-80% completed,13 th floor -70% completed
  • Dadoing of Kitchen walls :1st floor -40% completed
  • Water proofing -(1-12 th floor )100%completed,13 th floor 70% completed,14 th floor -80% completed.
  • Inside Putty work (1st coat) – 1-100% ,2st to 9th floor (90% completed),11 th ,12 th -90% completed
  • First coat painting :1ST -50%,4-5TH-20% Completed,6th -12th -30% completed
  • Second coat Painting :1st floor -30% completed
  • Door frame fixing -100%completed
  • Electrical wall chasing :Bf1-70% completed,GF-12 th floor -100% completed,13 th floor -75% completed.
  • Wire Pulling :BF2-GF-30% Completed ,1-11 th -100% completed,12 th floor -90% completed,13 th floor -50% completed.
  • Tiling work – 1st-9 th floor (95% completed); ,10 th floor (90%completed),11 th floor (90%completed),12 th floor (90%completed),13 th floor -60% completed
  • Plumbing : 1-12th floor-100% -completed,13 th floor -50% completed
  • DB & Switch fixing :1-40%,(,4th,5th )-10% ,6th to 13 th -30% completed.
  • cp sanitary fittings -FF-30% completed
  • Aluminium Fabrication work – 1-9-80% completed,10-13th -70% completed.
  • HT Electrical work-30% completed
  • Reticulated Gas Work-40% completed
  • Water proofing -(1-10 th floor )100%completed,11 th ,12thfloor -100% completed ,terrace area water proofing -40% completed.
  • Fire Work -80%completed
  • Balcony Handrail work -(1-12 th )50% completed
  • Door Shutter fixing :1-80%,2-60%,3-9th -50%completed,10 th –12 th floor 30% completed.
  • Lift work -70%completed
  • Amenity Block :RCC For super structure,block masonry -100%.ceiling plastering :100% ,doorframe fixing -50%,electrical chasing -90%,plumbing -50%,wall
  • plastering -100%, dadoing of toilets -70%,wire pulling -50%,Toilet water proofing -70% completed,flooring and skirting -60%. completed

As per the current work status from our site we are targeted to complete the following works by end of July 2019

  • Dadoing of toilets :12th-13th-80% completed
  • Inside Putty work (1st coat) -11 th ,12 th -100% to be completed
  • First coat painting :6th -12th -40% to be completed
  • Second coat Painting :5 th -10%,6 th -30%,7-12 th -20% tobe completed.
  • Plumbing : GF&12 th floor -80% to be completed
  • DB & Switch fixing :(,4th,5th )-20% to be completed.
  • cp sanitary fittings -4,5 th floor-10%,6 th-50%,7-9 th -25% to be completed
  • Aluminium Fabrication work – 1-12 th -90% completed.
  • Balcony Handrail work -(1-10 th )60% completed ,11-12 th -50% completed
  • Door Shutter fixing :1-9 th -75% completed,10-12 th -50% completed

Work status as on 06.07.2019, we have completed the following

  • Retaining wall – 96% completed
  • Earth work Excavation – 99% completed
  • Earth work & Back filling – 90% completed
  • RCC for Structure- 100% completed
  • Ceiling Plastering work – 100% completed
  • Block Masonry work – 100% completed
  • Wall Plastering work – GF,1st to 11th floor (100% completed); 12th floor (95% completed); Amenity Block (100% completed)
  • External Plastering work – 100% completed
  • Dadoing of toilets :1st -10thfloor -100% completed,,11-12th-80% completed
  • Dadoing of Kitchen walls :1st floor -40% completed
  • Water proofing -(1-12 th floor )100%completed,13 th floor 40% completed.
  • Inside Putty work (1st coat) – 1-100% ,2st to 9th floor (90% completed),11 th ,12 th -70% completed
  • First coat painting :1ST -50%,4-5TH-20% Completed,6th -12th -30% completed
  • Second coat Painting :1st floor -30% completed
  • Door frame fixing -100%completed
  • Electrical wall chasing :Bf1-70% completed,GF-12 th floor -100% completed,13 th floor -75% completed.
  • Wire Pulling :BF2-GF-30% Completed ,1-11 th -100% completed,12 th floor -90% completed.
  • Tiling work – 1st floor (95% completed); 2nd floor (95% completed); 3rd floor (95% completed); 4th floor (95% completed); 5th floor (95% completed); 6th floor (95% completed):7 th floor (95%completed),8th floor (95% completed):9 th floor 95%completed),10 th floor (90%completed),11 th floor (90%completed),12 th floor (90%completed),
  • Plumbing : 1-12th floor-100% -completed,13 th floor -50% completed
  • DB & Switch fixing :1-40%,(,4th,5th )-10% ,6th to 12 th -30% completed.
  • cp sanitary fittings -FF-30% completed
  • Aluminium Fabrication work – 1-9-80% completed,10-12th -50% completed.
  • HT Electrical work-30% completed
  • Reticulated Gas Work-40% completed
  • Water proofing -(1-10 th floor )100%completed,11 th ,12thfloor -100% completed ,terrace area water proofing -40% completed .
  • Fire Work -80%completed
  • Balcony Handrail work -(1-12 th )50% completed
  • Door Shutter fixing :1-80%,2-60%,3-5 th -30%completed,6 th -50% completed,7-12 th floor 30% completed.
  • HT Electrical work-30% completed
  • Amenity Block :RCC For super structure,block masonry -100%.ceiling plastering :100% ,doorframe fixing -50%,electrical chasing -90%,plumbing -50%,wall plastering -100%,wire pulling -50%,Toilet water proofing -40% completed.

As per the current work status from our site we are targeted to complete the following works by end of June 2019

  • Wall Plastering work – 12th floor – 100% to be completed.
  • External Plastering work – 100% to be completed
  • Dadoing of toilets :10-13,100 % to be completed
  • Inside Putty work (1st coat) – 11-12-100% to be completed.
  • First coat painting :4-5 (20%),6th (40%),7 th (30%),8-9(20%),10-11(30%) to be completed
  • Second coat Painting :5th floor-10%,6 th floor-30%,7th floor-12 th floor -20% to be completed
  • Tiling work – Terrace floor-100% to be completed
  • DB & Switch fixing :8 th floor-20% completed,10-12 th floor (25%) completed.
  • Aluminium Fabrication work – 1-10 th -85% to be completed,11-12 th -70% to be completed
  • Water proofing -Terrace -100% to be completed
  • Balcony Handrail work -(1-10 th )60% to be completed.
  • Door Shutter fixing :10 to 12(10 %) to be completed

Work status as on 06.06.2019, we have completed the following

  • Retaining wall – 96% completed
  • Earth work Excavation – 99% completed
  • Earth work & Back filling – 90% completed
  • RCC for Structure- 100% completed
  • Ceiling Plastering work – BF1(100% completed); BF2(100% completed);GF (100% completed); 1st to 12th floor (100% completed); Amenity Block (100% completed)
  • Block Masonry work – GF (completed); 1st to 12th floor (100% completed); Amenity Block (100% completed)Parapet work – 100% to be completed
  • Wall Plastering work – GF,1st to 11th floor (100% completed); 12th floor (95% completed); Amenity Block (100% completed)
  • External Plastering work – 98% completed
  • Dadoing of toilets :1st -9 thfloor -100% completed,10th -75%,11-12th-50% completed
  • Dadoing of Kitchen walls :1st floor -40% completed
  • Inside Putty work (1st coat) – 1-100% ,2st to 9th floor (90% completed),11 th ,12 th -70% completed
  • First coat painting :1ST -50%,4-6 TH-10% Completed,6th -30%,7-8th -25%,10-11 -10% completed
  • Second coat Painting :1st floor -30% completed
  • Door frame fixing -100%completed
  • Electrical wall chasing :Bf1-70% completed,GF-12 th floor -100% completed,13 th floor -75% completed.
  • Wire Pulling :1-11 th -100% completed,12 th floor -90% completed.
  • Tiling work – 1st floor (95% completed); 2nd floor (95% completed); 3rd floor (95% completed); 4th floor (95% completed); 5th floor (95% completed); 6th floor (95% completed):7 th floor (95%completed),8th floor (95% completed):9 th floor 95%completed),10 th floor (90%completed),11 th floor (90%completed),12 th floor (90%completed),
  • Plumbing : 1-12th floor-100% -completed,13 th floor -50% completed
  • DB & Switch fixing :1-40%,(,4th,5th ,8th,9th,11th )-10% ,6th -30% completed,7 th -20% completed.
  • cp sanitary fittings -FF-30% completed
  • Aluminium Fabrication work – 1-8-80% completed,9-10 th -50% completed,11&12 th floor (20% completed)
  • HT Electrical work-30% completed
  • Staircase Handrail-Fire stair -100% completed,Main stair -1 nos -100% completed
  • Reticulated Gas Work-40% completed
  • Water proofing -(1-10 th floor )100%completed,11 th ,12thfloor -100% completed ,terrace area water proofing -40% completed.
  • Fire Work -80%completed
  • Balcony Handrail work -(1-12 th )50% completed
  • Door Shutter fixing :1-80%,2-60%,3-30%,4 th -20%,5 th-20%,6 th -50%,7 th-30%,8 th -30%,9 th -20%,11 th-20% completed
  • HT Electrical work-30% completed
  • Amenity Block :RCC For super structure,block masonry -100%.ceiling plastering :95% ,doorframe fixing -50%,electrical chasing -75%,plumbing -50%,wall plastering -100%,external plastering -90%,waterproofing -40% completed

As per the current work status from our site we are targeted to complete the following works by end of May 2019

  • Wall Plastering work – 12th floor – 100% to be completed.
  • External Plastering work – 100% to be completed
  • Dadoing of toilets :10-13,100 % to be completed
  • Inside Putty work (1st coat) – 11-12-100% to be completed.
  • Tiling work – Terrace floor-100% to be completed
  • DB & Switch fixing :9-12 th -(25% to be completed)
  • Aluminium Fabrication work – 1-10 th -85% to be completed,11-12 th -70% to be completed
  • Water proofing -Terrace -100% to be completed
  • Balcony Handrail work -(1-10 th )60% to be completed ,10-11(30%),12 th-25% to be completed
  • Door Shutter fixing :1-9th-75% to be completed

Work status as on 06.05.2019, we have completed the following

  • Retaining wall – 96% completed
  • Earth work Excavation – 99% completed
  • Earth work & Back filling – 90% completed
  • RCC for Structure- 100% completed
  • Ceiling Plastering work – BF1(100% completed); BF2(100% completed);GF (100% completed); 1st to 12th floor (100% completed); Amenity Block (100% completed)
  • Block Masonry work – GF (completed); 1st to 12th floor (100% completed); Amenity Block (100% completed)Parapet work – 100% to be completed
  • Wall Plastering work – GF,1st to 11th floor (100% completed); 12th floor (95% completed); Amenity Block (100% completed)
  • External Plastering work – 98% completed
  • Dadoing of toilets :1st -9 thfloor -100% completed,10th -75%,11-12th-50% completed
  • Dadoing of Kitchen walls :1st floor -40% completed
  • Inside Putty work (1st coat) – 1-100% ,2st to 9th floor (90% completed),11 th ,12 th -70% completed
  • First coat painting :1ST -50%,4-6 TH-10% Completed,6th -30%,7-8th -25%,10-11 -10% completed
  • Secoond coat Painting :1st floor -30% completed
  • Door frame fixing -100%completed
  • Electrical wall chasing :Bf1-70% completed,GF-12 th floor -100% completed,13 th floor -75% completed.
  • Wire Pulling :1-11 th -100% completed,12 th floor -90% completed.
  • Tiling work – 1st floor (95% completed); 2nd floor (95% completed); 3rd floor (95% completed); 4th floor (95% completed); 5th floor (95% completed); 6th floor (95% completed):7 th floor (95%completed),8th floor (95% completed):9 th floor 95%completed),10 th floor (70%completed),11 th floor (60%completed),12 th floor (20%completed),
  • Plumbing : 1-12th floor-100% -completed,13 th floor -50% completed
  • DB & Switch fixing :5th ,8th -10% ,6th -25% completed
  • cp sanitary fittings -FF-30% completed
  • Aluminium Fabrication work – 1-8-80% completed,9-10 th -30% completed
  • HT Electrical work-30% completed
  • Staircase Handrail-Fire stair -100% completed,Main stair -1 nos -100% completed
  • Reticulated Gas Work-40% completed
  • Water proofing -(1-10 th floor )100%completed,11 th ,12thfloor -100% completed ,terrace area water proofing -40% completed .
  • Commercial building -Super structure -30% completed
  • Fire Work -80%completed
  • Balcony Handrail work -(1-12 th )50% completed
  • Door Shutter fixing :1-80%,2-60%,3-30%
  • Amenity Block :RCC For super structure,block masonry -100%.ceiling plastering :95% ,doorframe fixing -50%,electrical chasing -75%,plumbing -50%,wall plastering -100%,external plastering -90%,waterproofing -40% completed

As per the current work status from our site we are targeted to complete the following works by end of April 2019

  • Retaining wall – 100% to be completed
  • Earth work Excavation – 100% to be completed
  • Earth work & Back filling – 100% to be completed
  • Wall Plastering work – 12th floor – 100% to be completed
  • External Plastering work – 100% to be completed
  • Inside Putty work (1st coat) – 11th,12 th floor – 100% to be completed
  • Tiling work – 10th floor ,11th ,12thfloor (95% to be completed)
  • Plumbing :85% to be completed
  • LT Electrical work: 85% to be completed
  • Aluminium Fabrication work – 80% to be completed
  • Reticulated Gas Work-60% to be completed
  • water proofing -terrace floor-50% to be completed
  • Fire Work -100%completed
  • Balcony Handrail work -75 % to be completed

Work status as on 05.04.2019, we have completed the following

  • Retaining wall – 96% completed
  • Earth work Excavation – 99% completed
  • Earth work & Back filling – 90% completed
  • RCC for Structure- 100% completed
  • Ceiling Plastering work – BF1(100% completed); BF2(100% completed);GF (100% completed); 1st to 12th floor (100% completed); Amenity Block (100% completed)
  • Block Masonry work – GF (completed); 1st to 12th floor (100% completed); Amenity Block (100% completed)Parapet work – 100% to be completed
  • Wall Plastering work – GF,1st to 11th floor (100% completed); 12th floor (95% completed); Amenity Block (100% completed)
  • External Plastering work – 98% completed
  • Inside Putty work (1st coat) – 1st to 10th floor (100% completed),11 th ,12 th -50% completed
  • Door frame fixing -100%completed
  • Tiling work – 1st floor (95% completed); 2nd floor (95% completed); 3rd floor (95% completed); 4th floor (95% completed); 5th floor (95% completed); 6th floor (95% completed):7 th floor (95%completed),8th floor (95% completed):9 th floor (80%completed),10 th floor (70%completed),11 th floor (60%completed),12 th floor (20%completed),
  • Plumbing : 75% completed
  • LT Electrical work: 75% completed
  • Aluminium Fabrication work – 70% completed
  • HT Electrical work-30% completed
  • Staircase Handrail-Fire stair -100% completed,Main stair -1 nos -100% completed
  • Reticulated Gas Work-40% completed
  • Water proofing -(1-10 th floor )100%completed,11 th floor -100% completed ,terrace area water proofing -25% completed .
  • Commercial building -Super structure -30% completed
  • Fire Work -80%completed
  • Balcony Handrail work -50% completed

As per the current work status from our site we are targeted to complete the following works by end of March 2019

  • Retaining wall – 100% to be completed
  • Earth work Excavation – 100% to be completed
  • Earth work & Back filling – 100% to be completed
  • Wall Plastering work – 12th floor – 100% to be completed.
  • External Plastering work – 100% to be completed
  • Inside Putty work (1st coat) – 11th floor – 100% to be completed
  • Tiling work – 10th floor &11th floor (95% to be completed),
  • Plumbing :85% to be completed
  • LT Electrical work: 85% to be completed
  • Aluminium Fabrication work – 75% to be completed.
  • Waterproofing -terrace floor-75% to be completed

Work status as on 06-03-2019, we have completed the following

  • Retaining wall – 96% completed
  • Earth work Excavation – 99% completed
  • RCC for Pile cap & Grade beam – 100% completed
  • Earth work & Back filling – 90% completed
  • RCC for Structure- 100% completed
  • Ceiling Plastering work – BF1(90% completed); BF2(100% completed);GF (100% completed); 1st to 12th floor (100% completed); Amenity Block (100% completed)
  • Block Masonry work – GF (completed); 1st to 12th floor (100% completed); Amenity Block (100% completed)Parapet work – 100% to be completed
  • Wall Plastering work – GF,1st to 11th floor (100% completed); 12th floor (95% completed)
  • Amenity Block (100% completed)
  • External Plastering work – 98% completed
  • Inside Putty work (1st coat) – 1st to 10th floor (100% completed)
  • Door frame fixing -100%completed
  • Tiling work – 1st floor (95% completed); 2nd floor (95% completed); 3rd floor (95% completed); 4th floor (95% completed); 5th floor (95% completed); 6th floor (95% completed):7th floor (80%completed),8th floor (80% completed):9 th floor (60%completed),
  • Plumbing : 75% completed
  • LT Electrical work: 75% completed
  • Aluminium Fabrication work – 60% completed
  • HT Electrical work-25% completed
  • Staircase Handrail-Fire stair -100% completed,Main stair -1 nos -80% completed
  • Reticulated Gas Work-20% completed
  • Water proofing -(1-10th floor )100%completed, 11th floor -100% completed ,terrace area waterproofing in progress

As per the current work status from our site we are targeted to complete the following works by end of February 2019

  • Retaining wall – 100% to be completed
  • Earth work Excavation – 100% to be completed
  • Earth work & Back filling – 100% to be completed
  • Wall Plastering work – 12th floor – 100% to be completed.
  • External Plastering work – 100% to be completed
  • Inside Putty work (1st coat) – 11th floor – 100% to be completed
  • Tiling work – 8th floor &9 th floor (95% to be completed),
  • Plumbing :85% to be completed
  • LT Electrical work: 85% to be completed
  • Aluminium Fabrication work – 75% to be completed.
  • Waterproofing ,11 th floor -100%to be completed, water proofing -75% to be completed

Work status as on 05-02-2019, we have completed the following

  • Retaining wall – 96% completed
  • Earth work Excavation – 99% completed
  • RCC for Pile cap & Grade beam – 100% completed
  • Earth work & Back filling – 90% completed
  • RCC for Structure- 100% completed
  • Ceiling Plastering work – BF1(90% completed); BF2(95% completed);GF (100% completed);
  • 1st to 12th floor (100% completed); Amenity Block (100% completed)
  • Block Masonry work – GF (completed); 1st to 12th floor (100% completed); Amenity Block
  • (100% completed)Parapet work – 100% to be completed
  • Wall Plastering work – 1st to 11th floor (100% completed); 12th floor (95% completed);
  • Amenity Block (100% completed)
  • External Plastering work – 95% completed
  • Inside Putty work (1st coat) – 1st to 10th floor (100% completed)
  • Door frame fixing -100%completed
  • Tiling work – 1st floor (95% completed); 2nd floor (95% completed); 3rd floor (95% completed); 4th floor (95% completed); 5th floor (95% completed); 6th floor (95% completed):7 th floor (80%completed),8th floor (80% completed):9 th floor (60%completed),
  • Plumbing : 75% completed
  • LT Electrical work: 70% completed
  • Aluminium Fabrication work – 50% completed
  • Water proofing -(1-10 th floor )100%completed,11 th floor -80% completed ,terrace area water proofing in progress

As per the current work status from our site we are targeted to complete the following works by end of January 2019

  • Retaining wall – 100% to be completed
  • Earth work Excavation – 100% to be completed
  • Earth work & Back filling – 100% to be completed
  • Ceiling Plastering work – Amenity roof slab – 100% to be completed
  • Block Masonry work – Parapet work – 100% to be completed
  • Wall Plastering work – 12th floor – 100% to be completed.
  • External Plastering work – 100% to be completed
  • Inside Putty work (1st coat) – 11th floor – 100% to be completed
  • Tiling work – 7th floor – 95% to be completed; 8th floor ,9 th floor -80% to be completed.
  • Plumbing :85% to be completed
  • LT Electrical work: 85% to be completed
  • Aluminium Fabrication work – 60% to be completed.
  • water proofing ,11&12 th floor -100%to be completed,terrace area water proofing -50% to be completed

Work status as on 08-01-2019, we have completed the following

  • Retaining wall – 96% completed
  • Earth work Excavation – 99% completed
  • RCC for Pile cap & Grade beam – 100% completed
  • Earth work & Back filling – 90% completed
  • RCC for Slab – 100% completed
  • Ceiling Plastering work – BF1(90% completed); BF2(95% completed);GF (95% completed); 1st to 12th floor (100% completed);Amenity Block (90% completed)
  • Block Masonry work – GF (completed); 1st to 12th floor (100% completed); Amenity Block (100% completed)
  • Wall Plastering work – 1st to 11th floor (100% completed); 12th floor (95% completed); Amenity Block (100% completed)
  • External Plastering work – 90% completed
  • Inside Putty work (1st coat) – 1st to 10th floor (100% completed)
  • Door frame fixing -100%completed
  • Tiling work – 1st floor (95% completed); 2nd floor (95% completed); 3rd floor (95% completed); 4th floor (95% completed); 5th floor (95% completed); 6th floor (95% completed):7 th floor (80%completed)
  • Plumbing : 75% completed
  • LT Electrical work: 70% completed
  • Aluminium Fabrication work – 40% completed
  • Water proofing -(1-10 th floor )100%completed,11 th floor -in progress,terrace area water proofing in progress

As per the current work status from our site we are targeted to complete the following works by end of December 2019

  • Retaining wall – 100% to be completed
  • Earth work Excavation – 100% to be completed
  • Earth work & Back filling – 100% to be completed
  • Ceiling Plastering work – Amenity roof slab – 100% to be completed
  • Block Masonry work – Parapet work – 100% to be completed
  • Wall Plastering work – 12th floor & Amenity Block – 100% to be completed.
  • External Plastering work – 100% to be completed
  • Inside Putty work (1st coat) – 11th floor – 100% to be completed
  • Tiling work – 7th floor – 100% to be completed; 8th floor (100% to be completed)
  • Plumbing :75% to be completed
  • LT Electrical work: 75% to be completed
  • Aluminium Fabrication work – 40% to be completed.
  • water proofing ,11&12 th floor -100%to be completed,terrace area water proofing -50% to be completed

Work status as on 06-12-2018, we have completed the following

  • Retaining wall – 96% completed
  • Earth work Excavation – 99% completed
  • RCC for Pile cap & Grade beam – 100% completed
  • Earth work & Back filling – 90% completed
  • RCC for Slab – 100% completed
  • Ceiling Plastering work – BF1(90% completed); BF2(90% completed);GF (90% completed); 1st to 12th floor (100% completed);Amenity Block (80% completed)
  • Block Masonry work – GF (completed); 1st to 12th floor (100% completed); Amenity Block (100% completed)
  • Wall Plastering work – 1st to 11th floor (100% completed); 12th floor (95% completed); Amenity Block (90% completed)
  • External Plastering work – 80% completed
  • Inside Putty work (1st coat) – 1st to 10th floor (100% completed)
  • Door frame fixing -100%completed
  • Tiling work – 1st floor (90% completed); 2nd floor (90% completed); 3rd floor (90% completed); 4th floor (90% completed);
  • 5th floor (90% completed); 6th floor (90% completed):7 th floor (60%completed)
  • Plumbing : 60% completed
  • LT Electrical work: 50% completed
  • Aluminium Fabrication work – 20% completed
  • Water proofing -(1-10 th floor )100%completed,11 th floor -in progress,terrace area water proofing in progress

As per the current work status from our site we are targeted to complete the following works by end of December 2018.

  • Column work – 12th floor to 13th floor -100% to be completed
  • RCC Structure for Slab – 12th roof – 100% completed
  • RCC Structure for Slab – 13th roof – 100% to be completed
  • Ceiling Plastering work – 11th floor – 100% to be completed
  • Block Masonary work – 11th & 12th floor – 100% to be completed
  • Wall Plastering work – 9th & 10th floor – 100% to be completed
  • External Plastering work – 20% to be completed
  • Tile work 3rd & 4th floor – 100% to be completed

As per the current work status from our site, we are targeted to complete the following works by end of October 2018

  • RCC Structure for Slab – Lift machine room 100% to be completed
  • Ceiling Plastering work – amenity floor – 100% to be completed
  • Wall Plastering work – amenity floor – 100% to be completed
  • External Plastering work – 75% to be completed
  • Tile work 5th floor – 100% to be completed, further tiling will be done on priority basis.

Work status as on 28-09-2018, we have completed

  • Ceiling Plastering work -BF1, BF2 (80% completed) , GF (100% completed); 1st, 2nd floor ,3rd floor , 4th floor , 5th floor , 6th floor ,7th floor ,8th floor,9th floor ,10th floor,11th floor ,12th floor (100% completed), 13th floor 80% completed.
  • Block Masonry work – 13th floor (100 % completed)
  • Wall Plastering work – 12th floor (100% completed)
  • Tiling work – 4th floor (80% completed),5th floor (50% completed)
  • External plastering – (60% completed)

Work status as on 26-03-2018, we have completed

  • Retaining wall – 100% completed
  • Earth work Excavation – 100% completed
  • RCC for Pile cap & Grade beam – 100% completed
  • Earth work & Back filling – 100% completed
  • Column work – 9th to 10th floor – 100% completed
  • Column work – 10th to 11th floor – 100% completed
  • Column work – 11th to 12th floor – 100% completed
  • Column work – 12th to 13th floor 100% to be completed
  • RCC Structure for Slab – 9th roof – 100% completed
  • RCC Structure for Slab – 10th roof – 100% completed
  • RCC Structure for Slab – 11th roof – 100% completed
  • RCC Structure for Slab – 12th roof – 100% completed
  • Ceiling Plastering work -BF2 (80% completed) , GF (100% completed); 1st, 2nd floor ,3rd floor , 4th floor , 5th floor , 6th floor ,7th floor & 8th floor,9th floor,10th floor-100% completed,11th floor 80% completed)
  • Block Masonry work – 5th floor , 6th floor , 7th floor & 8th floor, 9th floor (100% completed); 10th floor(90% completed) , 11th floor (50% completed),12th floor(30% completed)
  • Wall Plastering work – 1st floor, 2nd floor , 3rd floor , & 4th floor(90% completed) , 5th floor & 6th floor (100% completed) , 7th floor (80% completed),8th floor(50%) ,9th floor(50% completed),10th floor(20% completed)

Work status as on 9-8-2017, we have completed

  • Retaining wall – progressing
  • RCC for Pile cap & Grade beam – completed
  • Column work – 8th to 9th floor – completed
  • RCC Structure for Slab – 8th roof – completed
  • Block Masonry work – 5th floor -completed
  • Wall Plastering work – 2nd floor -completed

Work status as on 5-7-2017, we have completed

  • Retaining wall – completed
  • Earth work Excavation – completed
  • RCC for Pile cap & Grade beam – completed
  • RCC Structure for Slab – progressing
  • Ceiling Plastering work – progressing
  • Block Masonry work – progressing

Work status as on 9-6-2017, we have completed

  • Retaining wall – completed
  • RCC for Pile cap & Grade beam – completed
  • Column work – progressing
  • RCC Structure for Slab – progressing
  • Ceiling Plastering work – progressing

Work status as on 9-5-2017, we have completed

  • Retaining wall – progressing
  • Earth work Excavation – progressing
  • RCC for Pile cap & Grade beam – completed
  • Column work – 4th to 5th floor – progressing
  • RCC Structure for Slab – 4th roof – progressing
  • Block Masonry work – 1st floor – progressing

Work status as on 8-3-2017, we have completed

  • Retaining wall – progressing
  • Earth work Excavation – progressing
  • RCC for Pile cap & Grade beam – completed
  • Column work – progressing

Work status as on 8-2-2017, we have completed:

  • Earth work Excavation – progressing
  • RCC for Pile cap & Grade beam – completed
  • Column work – progressing
  • RCC Structure for Slab – – progressing

Work status as on 06-5-2016, we have completed

  • Retaining wall – 40% completed
  • Earth work Excavation – 90% completed
  • RCC for Pile cap & Grade beam – 95% completed
  • Earth work & Back filling – 85% completed
  • RCC for Structure Slab – (B2 – 70% completed); (B1 – 70% completed); GF floor (65% completed); 1st floor (55% completed)

As per the current work status from our site we are targeted to complete the following works by end of May, 2016.

  • Retaining wall – 100% to be completed
  • RCC for Pile cap & Grade beam – 100% to be completed
  • RCC for Structure Slab – (B2 – 100% to be completed); (B1 – 100% to be completed); 1st floor (88% to be completed)

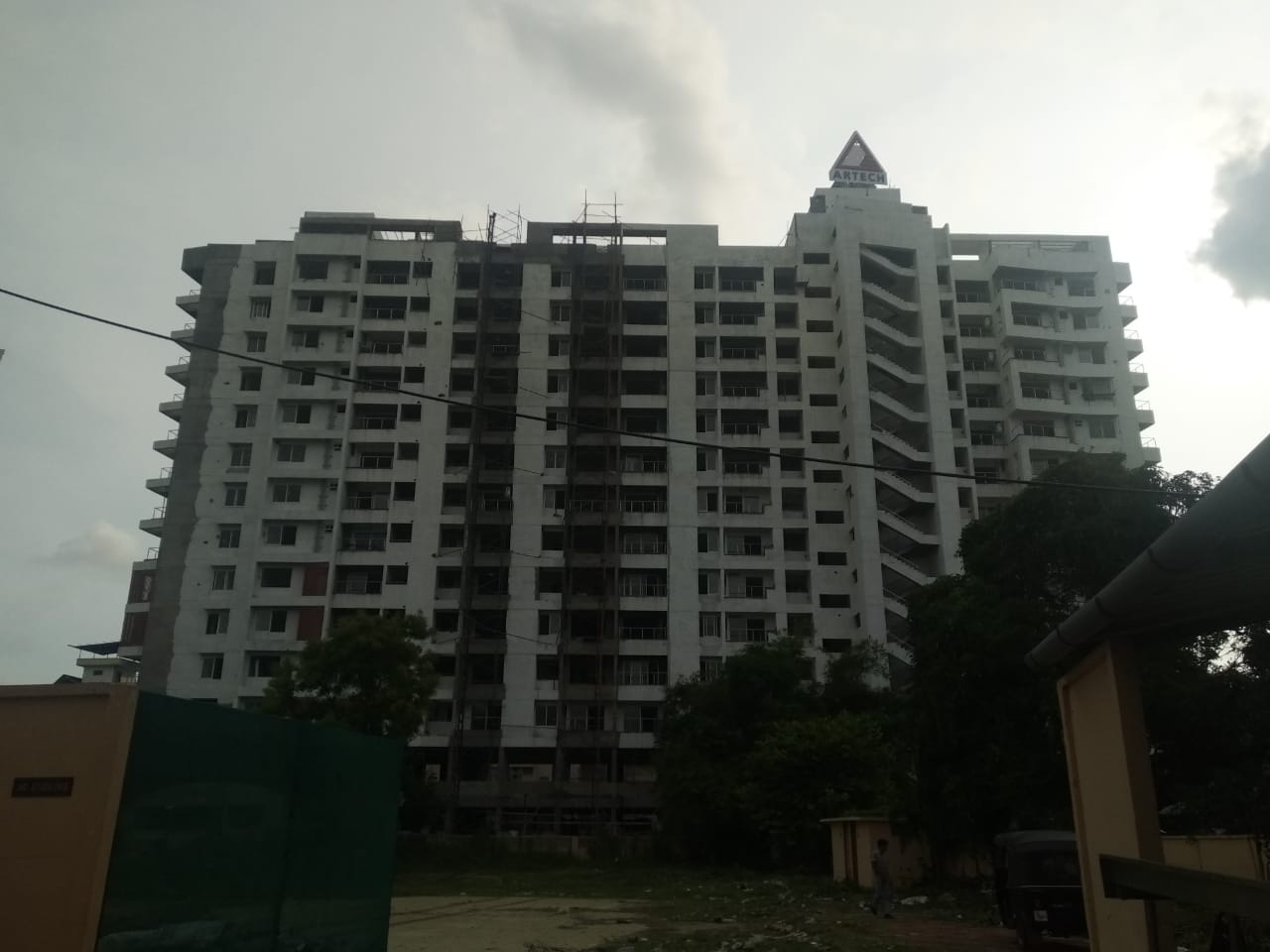

Current work progress at our site Artech Gateway, TB Road, Thrissur-
Work status as on 06-4-2016, we have completed

  • Retaining wall – 36% completed
  • Earth work Excavation – 90% completed
  • RCC for Pile cap & Grade beam – 95% completed
  • Earth work & Back filling – 85% completed
  • RCC for Structure Slab – (B2 – 70% completed); (B1 – 70% completed); GF floor (65% completed); 1st floor (30% completed)

As per the current work status from our site we are targeted to complete the following works by end of April, 2016.

  • Retaining wall – 100% to be completed
  • RCC for Pile cap & Grade beam – 100% to be completed
  • RCC for Structure Slab – (B2 – 100% to be completed); (B1 – 100% to be completed); 1st floor (82% to be completed)

Work status as on 05-1-2016, we have completed.

  • Earth work Excavation – 90% completed
  • RCC for Pile cap & Grade beam – 90% completed
  • Earth work & Back filling – 80% completed
  • Raft slab – 76% completed
  • RCC for Structure Slab (B2) – 70% completed

As per the current work status from our site we are targeted to complete the following works by the end of January, 2016.

  • Raft slab – 100% to be completed
  • RCC for Structure Slab (B2)- 100% to be completed

Tiling Work – 2nd floor (100% completed)
