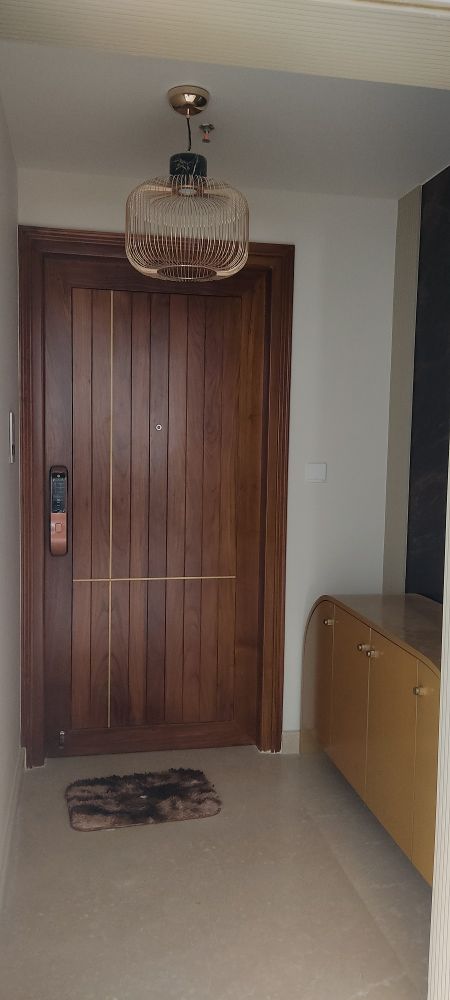

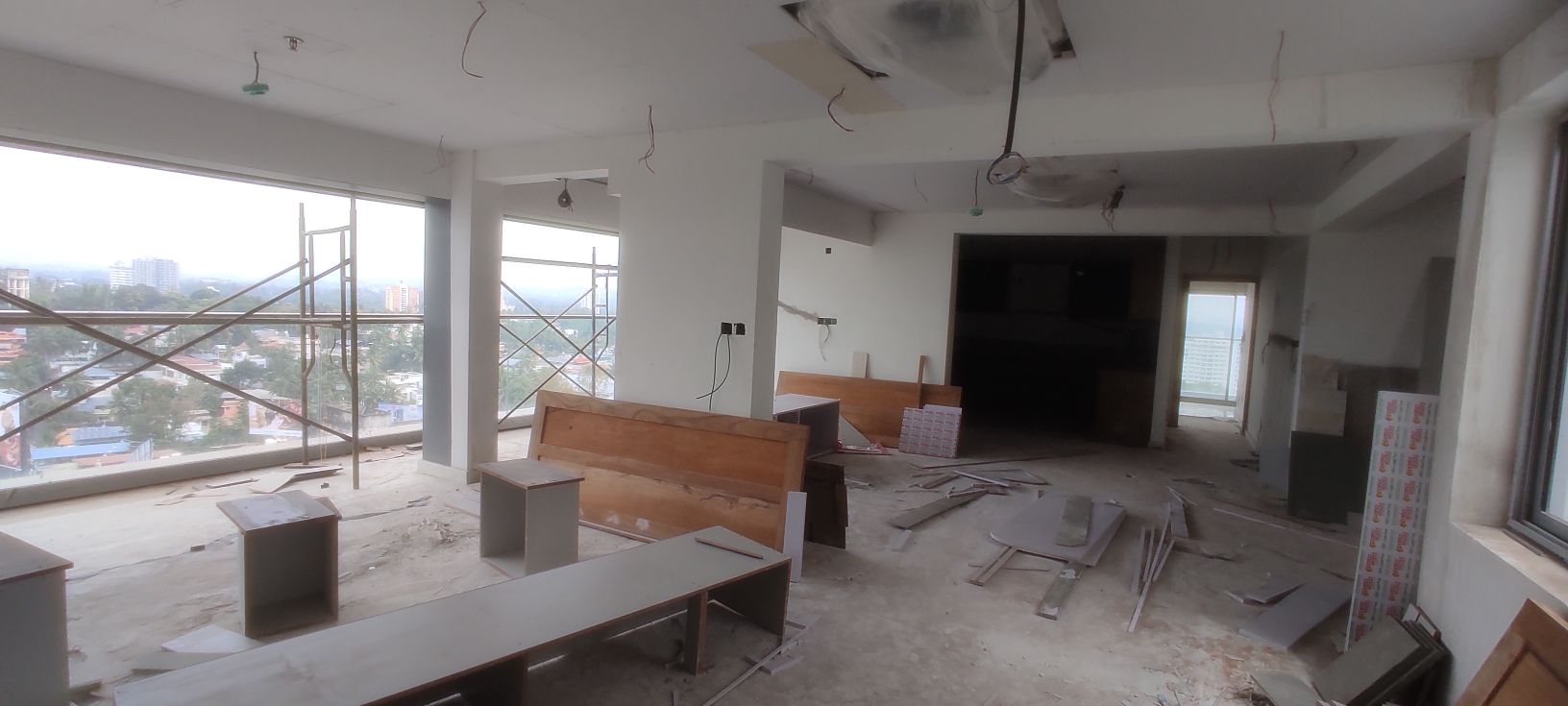

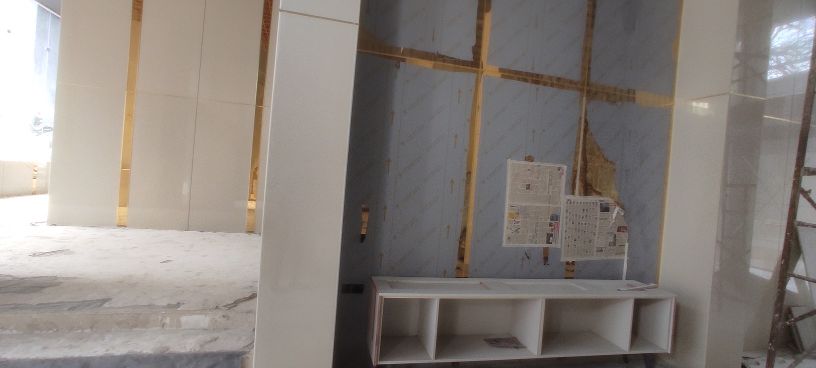

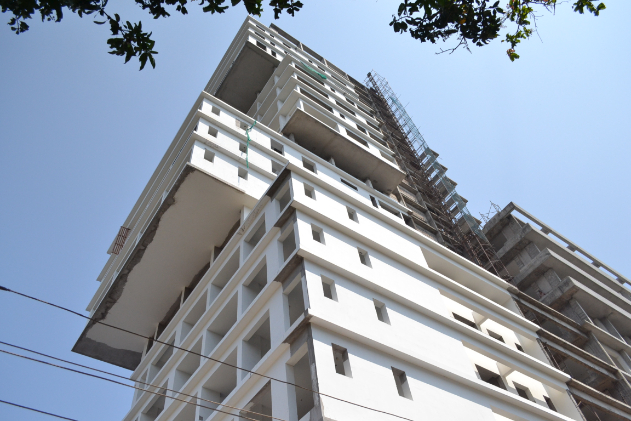

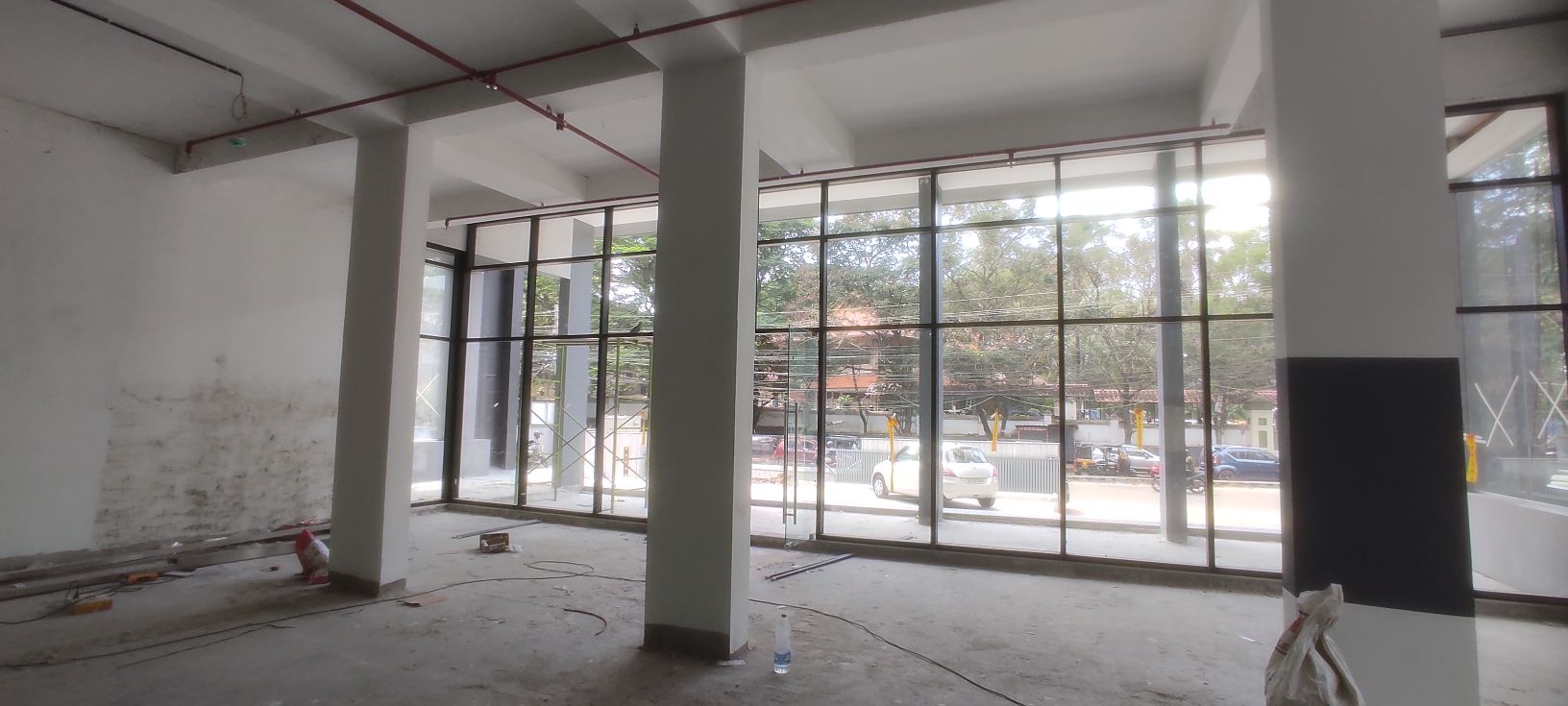

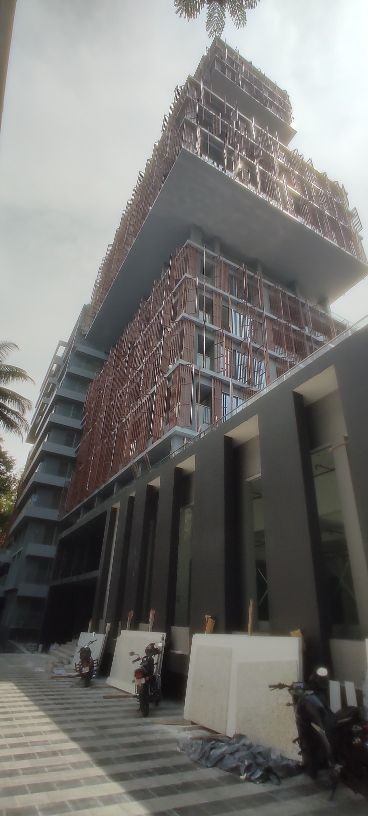

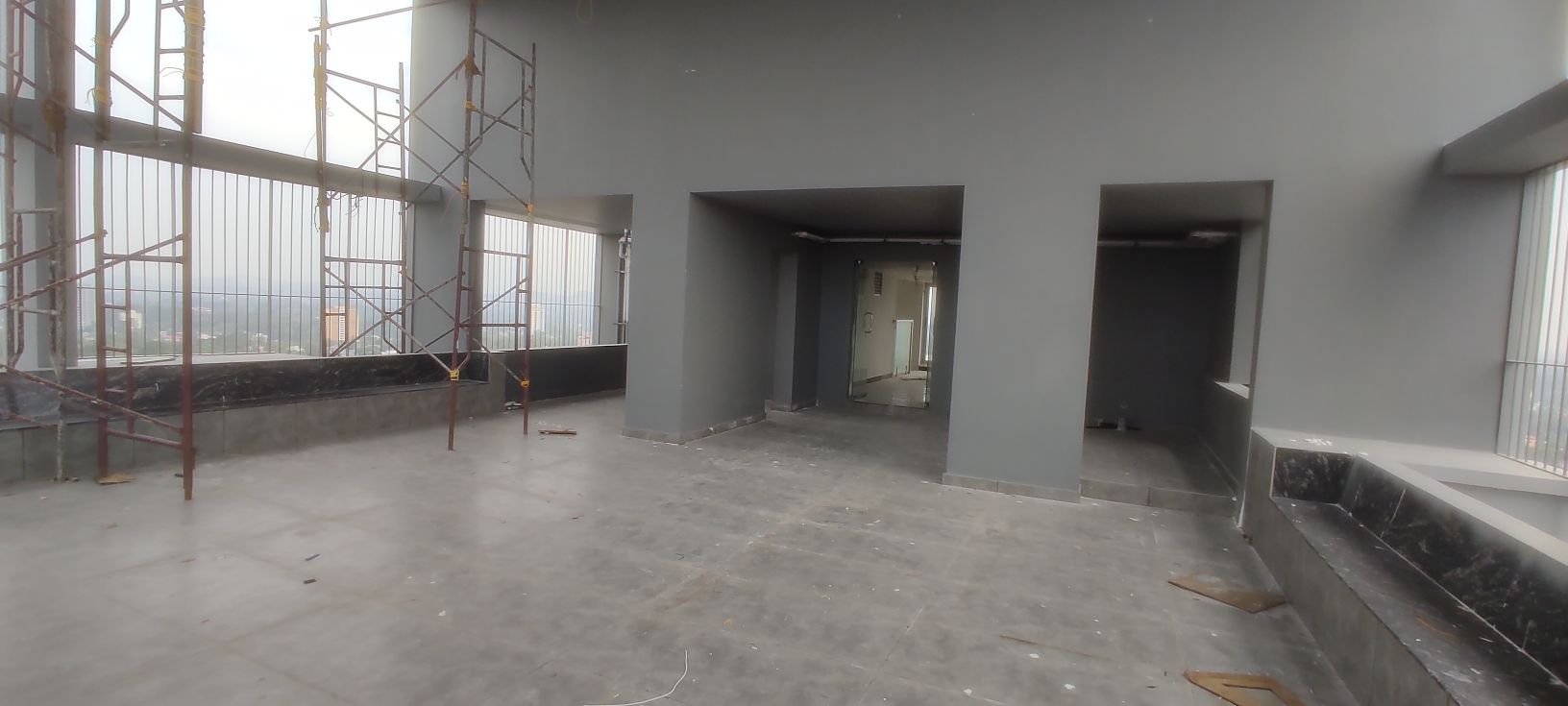

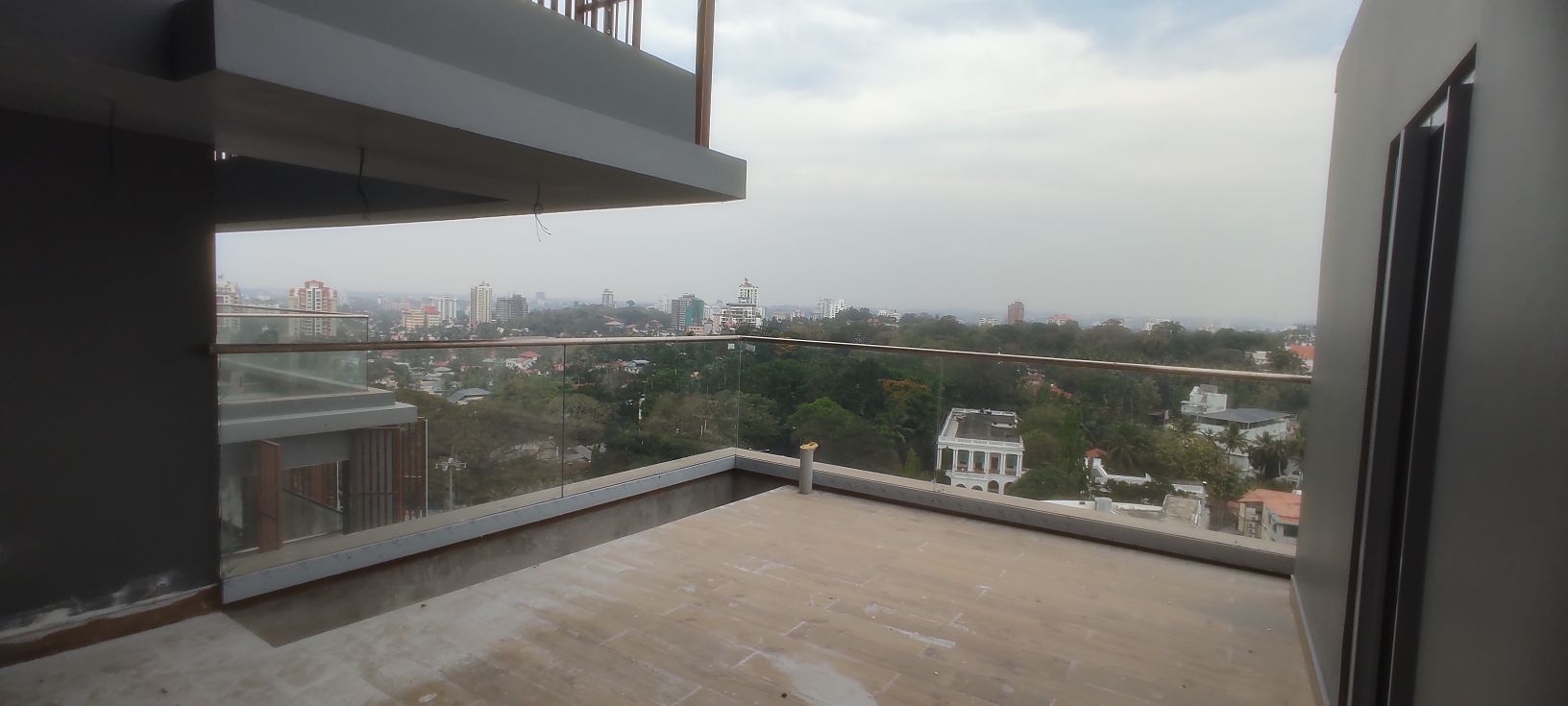

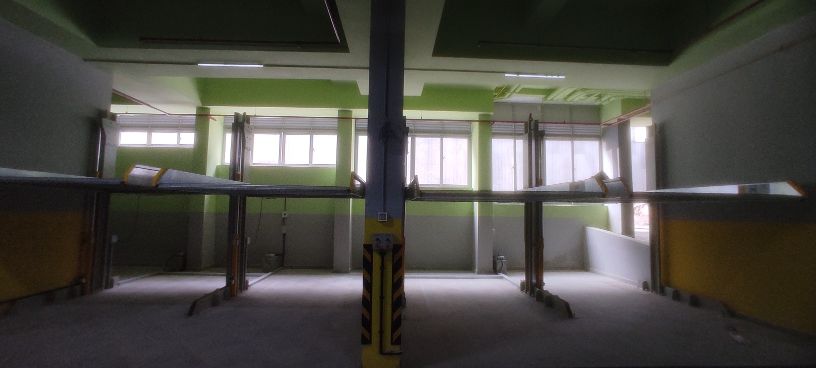

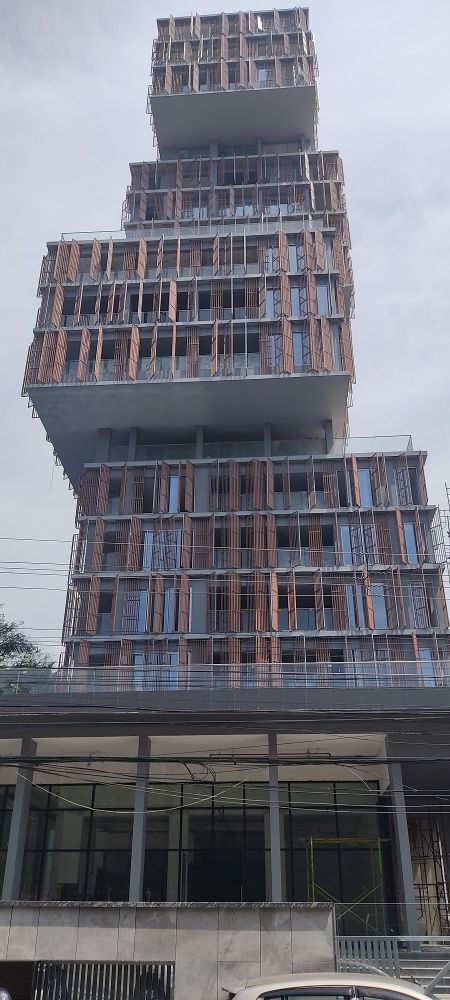

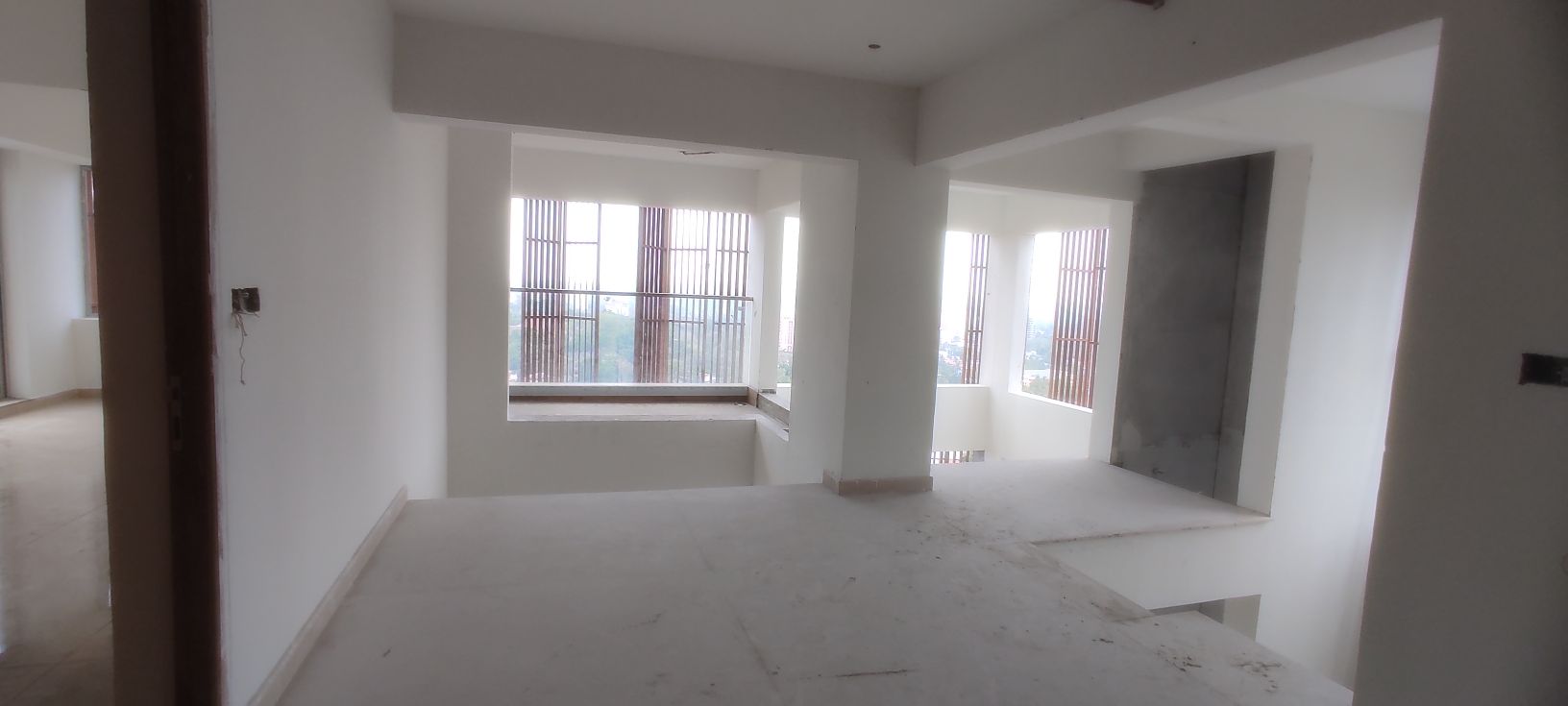

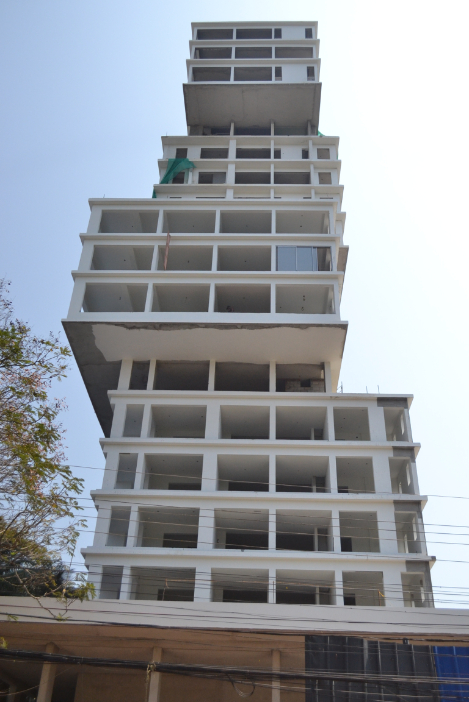

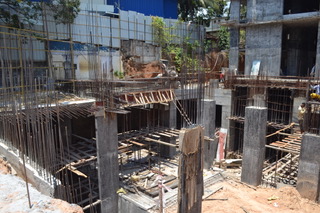

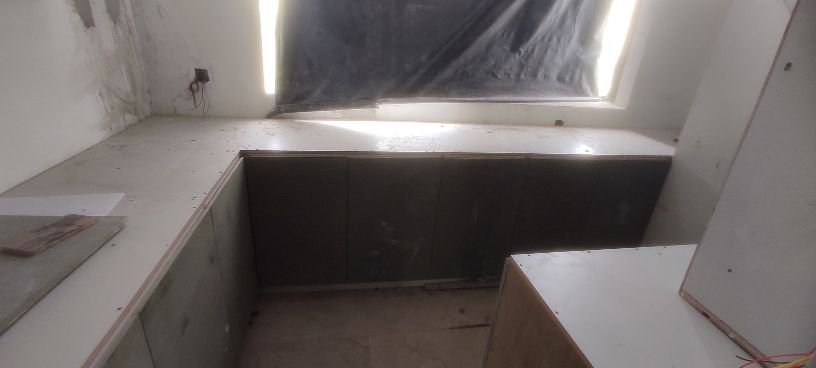

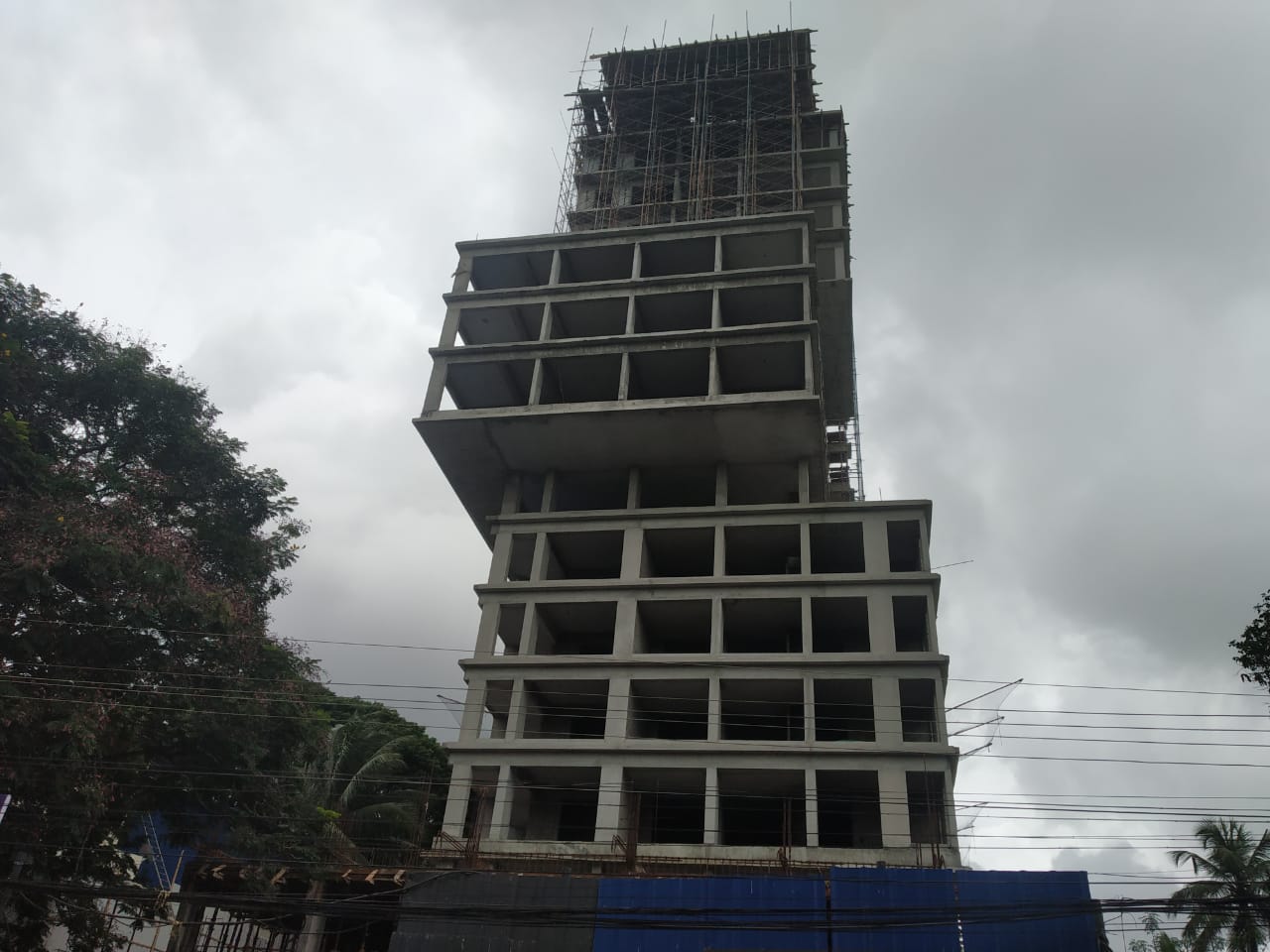

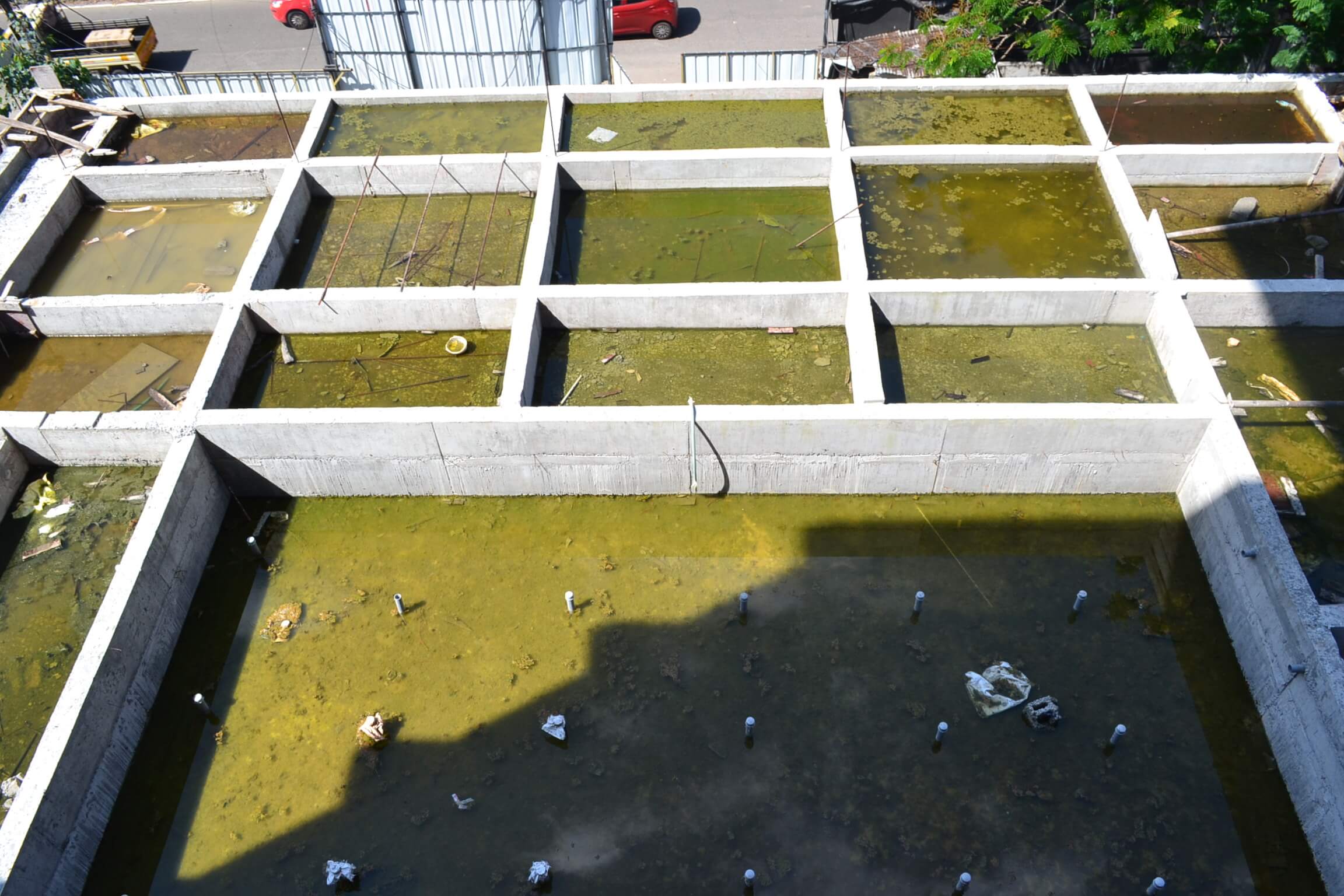

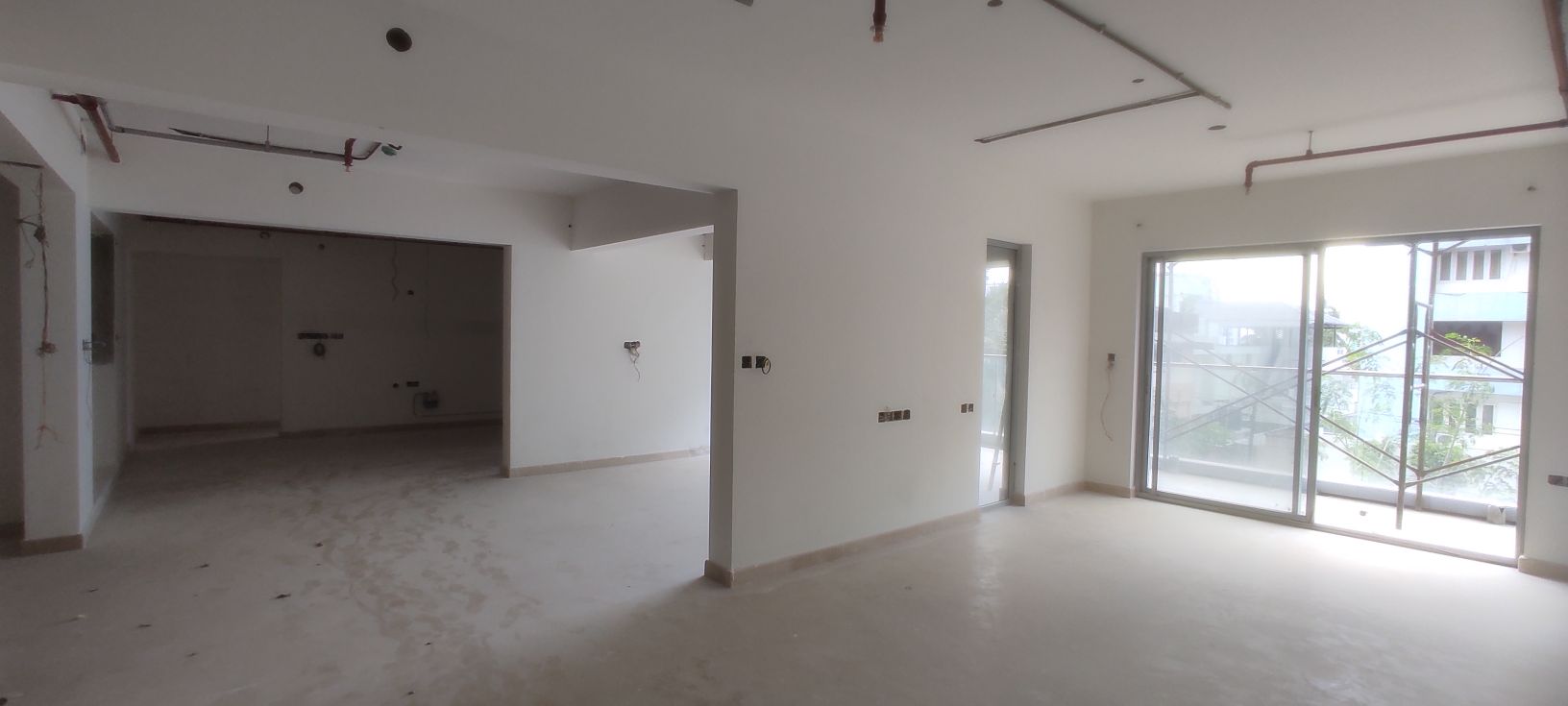

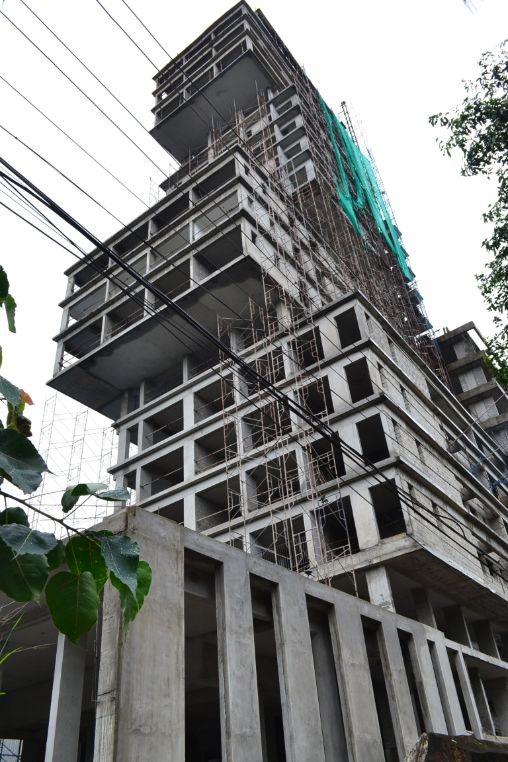

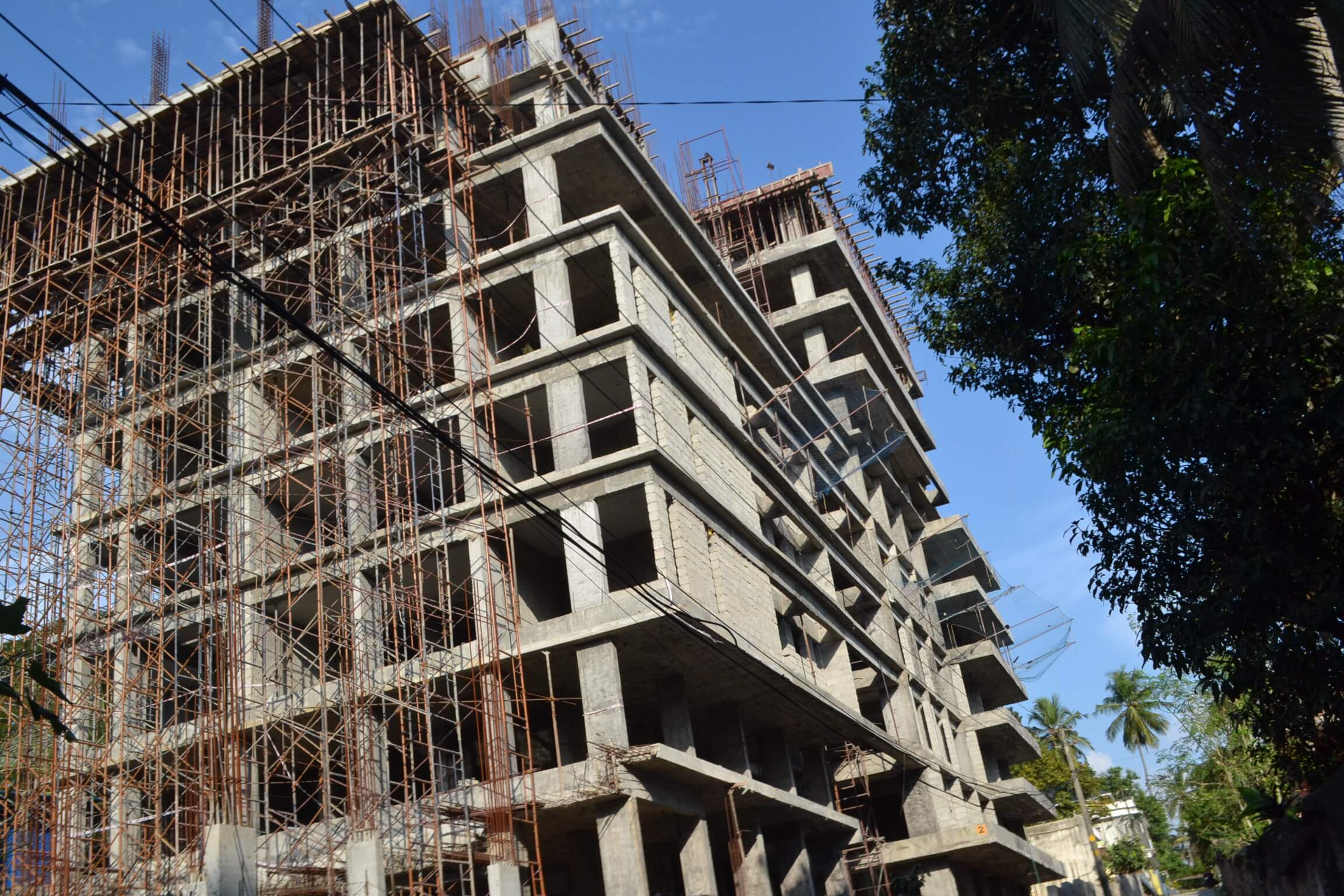

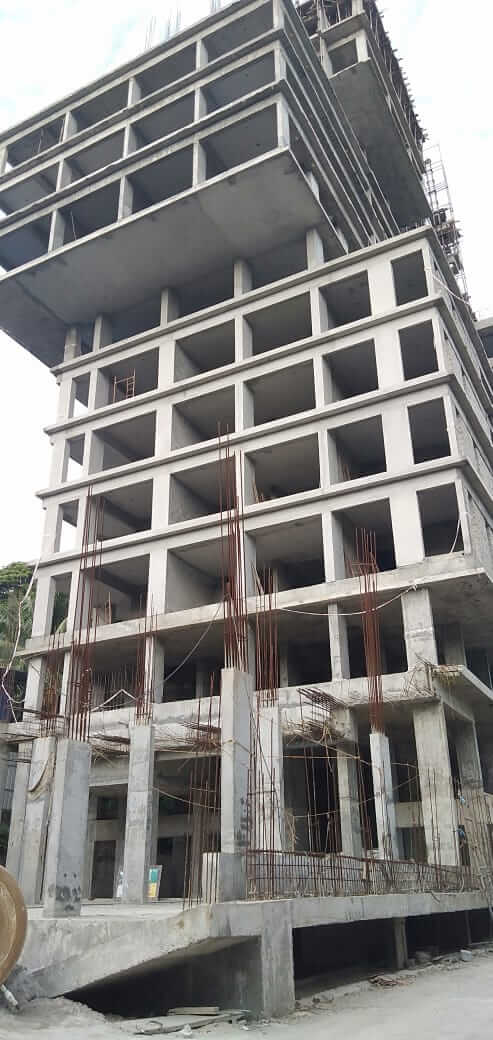

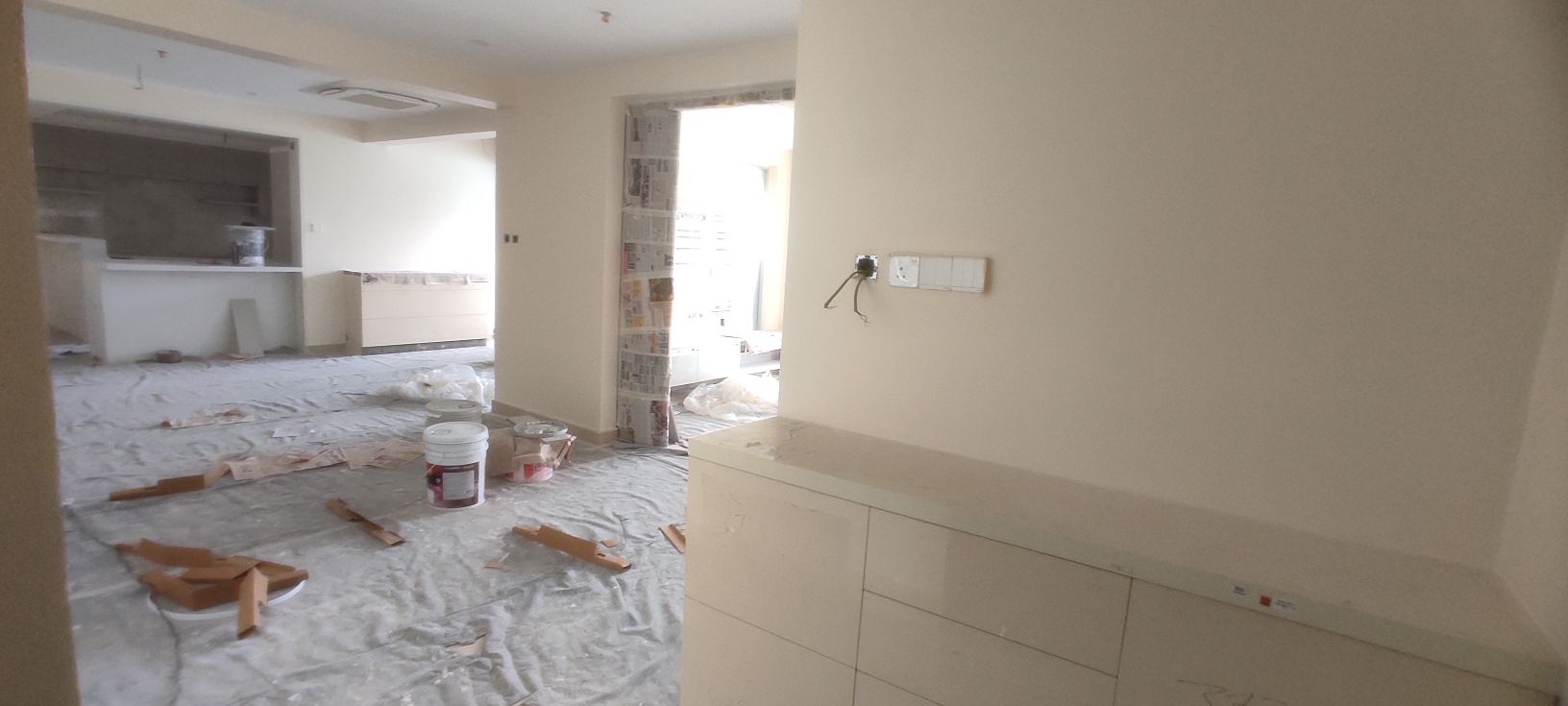

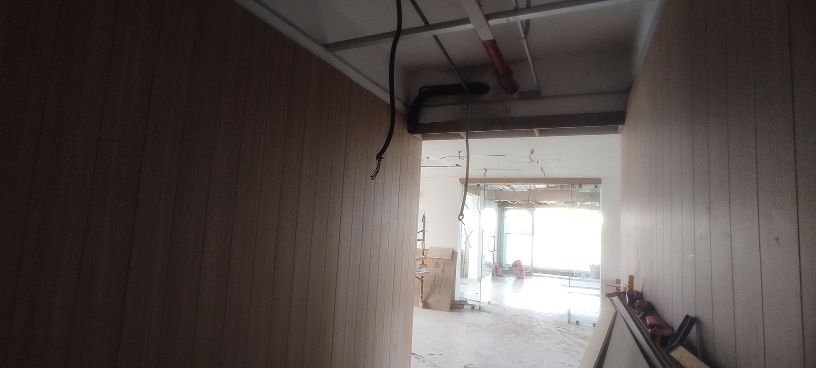

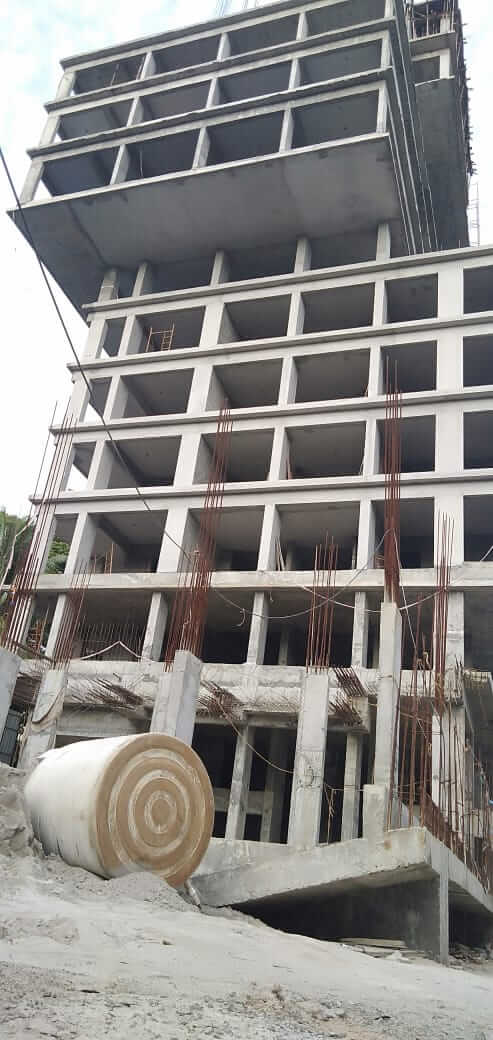

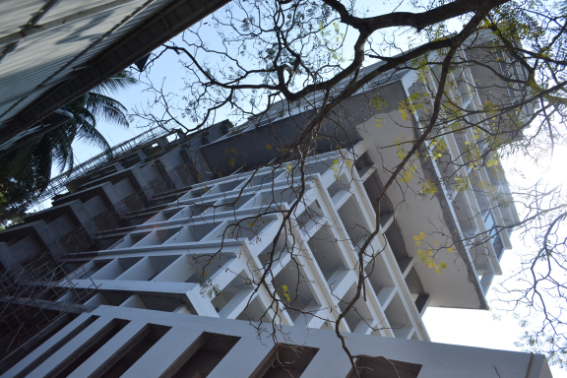

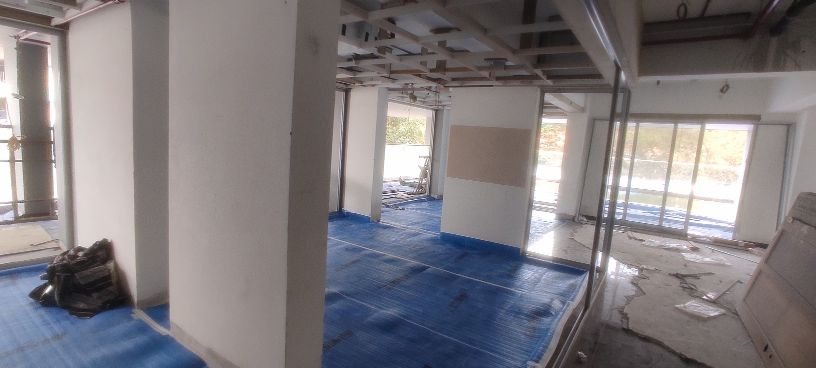

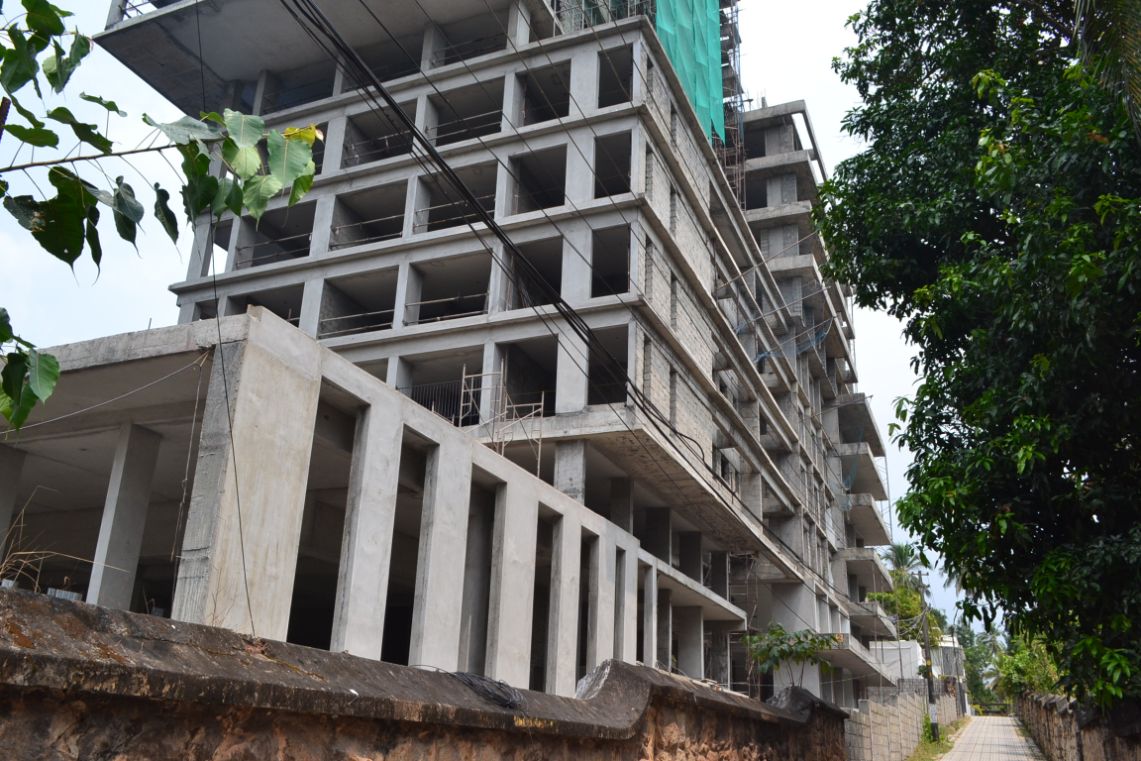

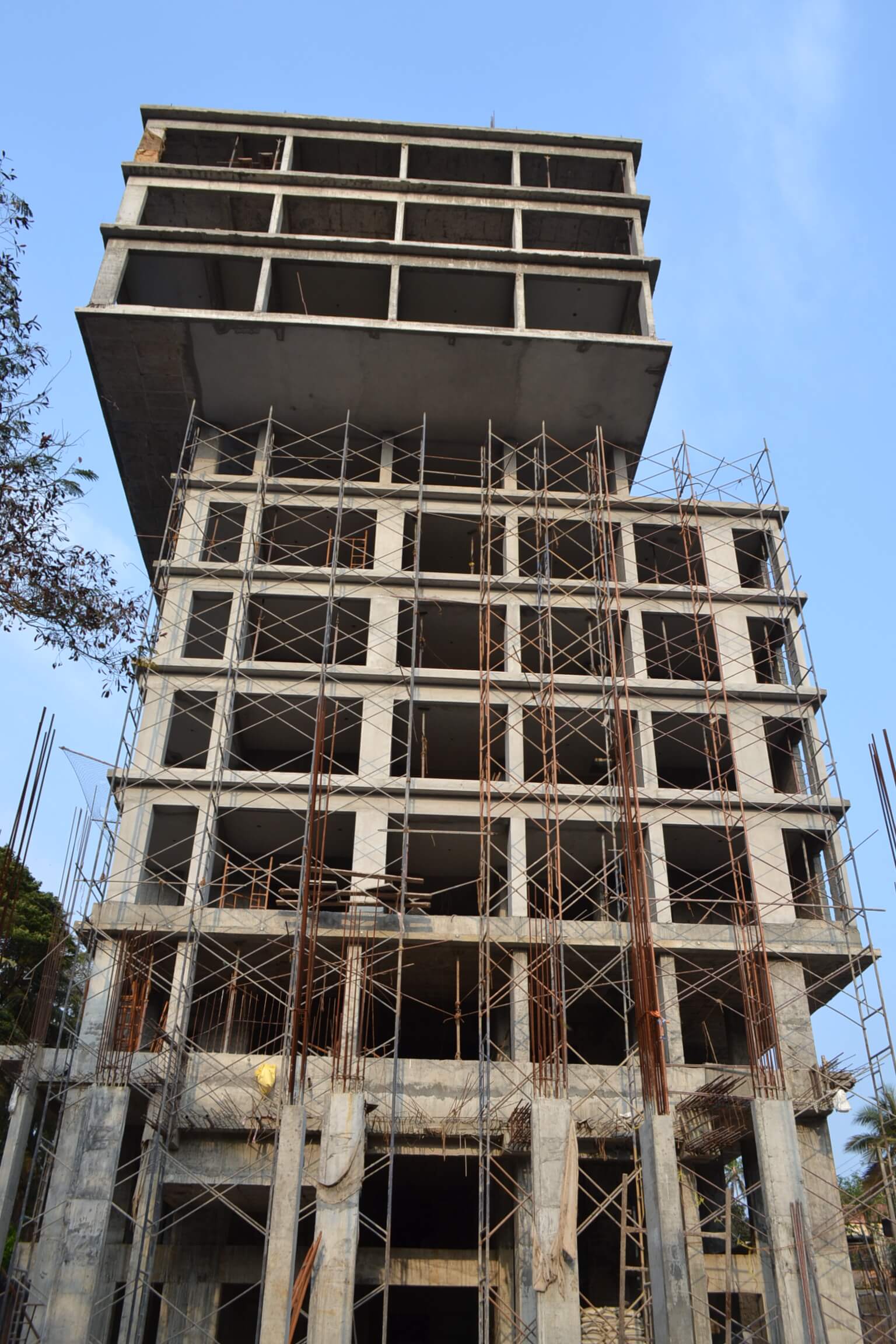

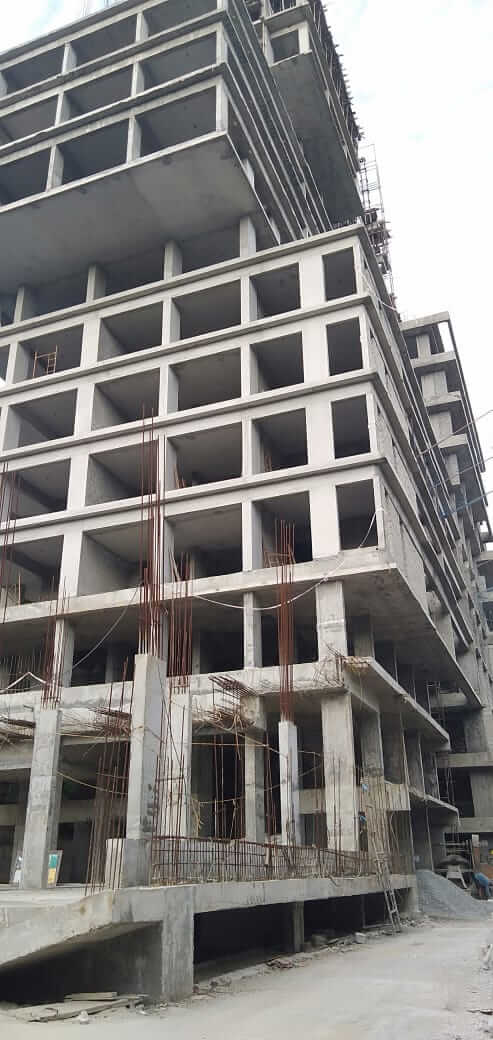

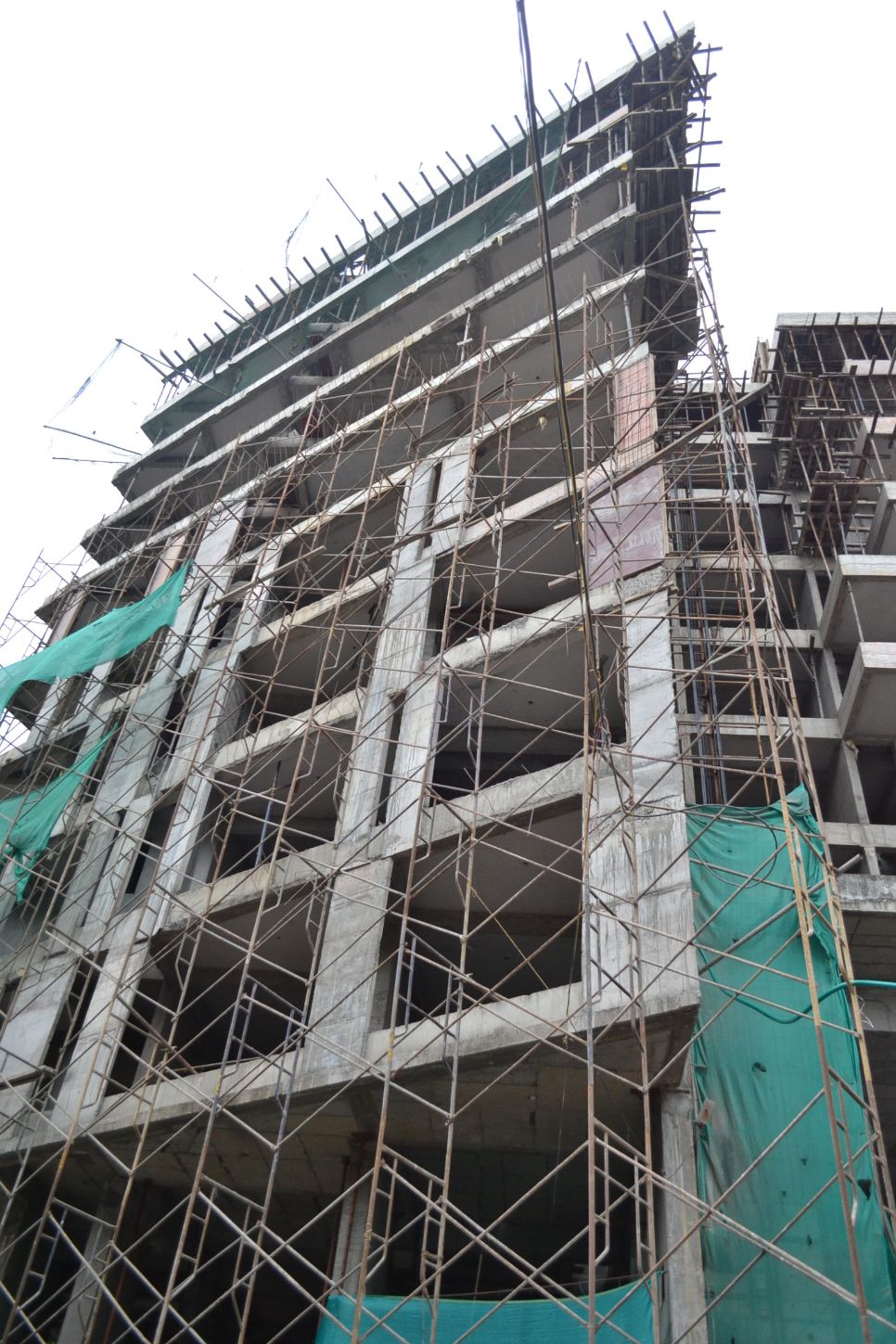

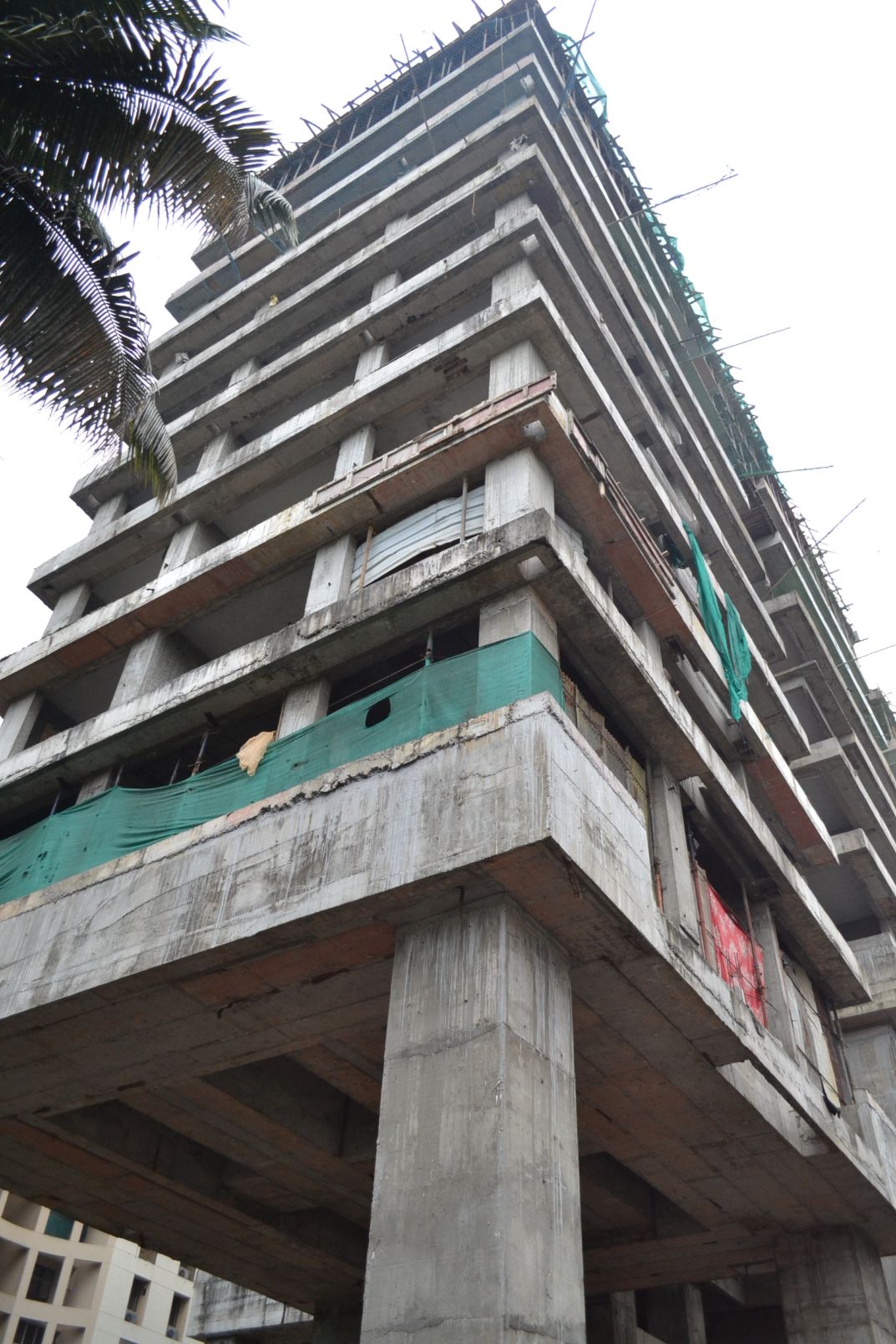

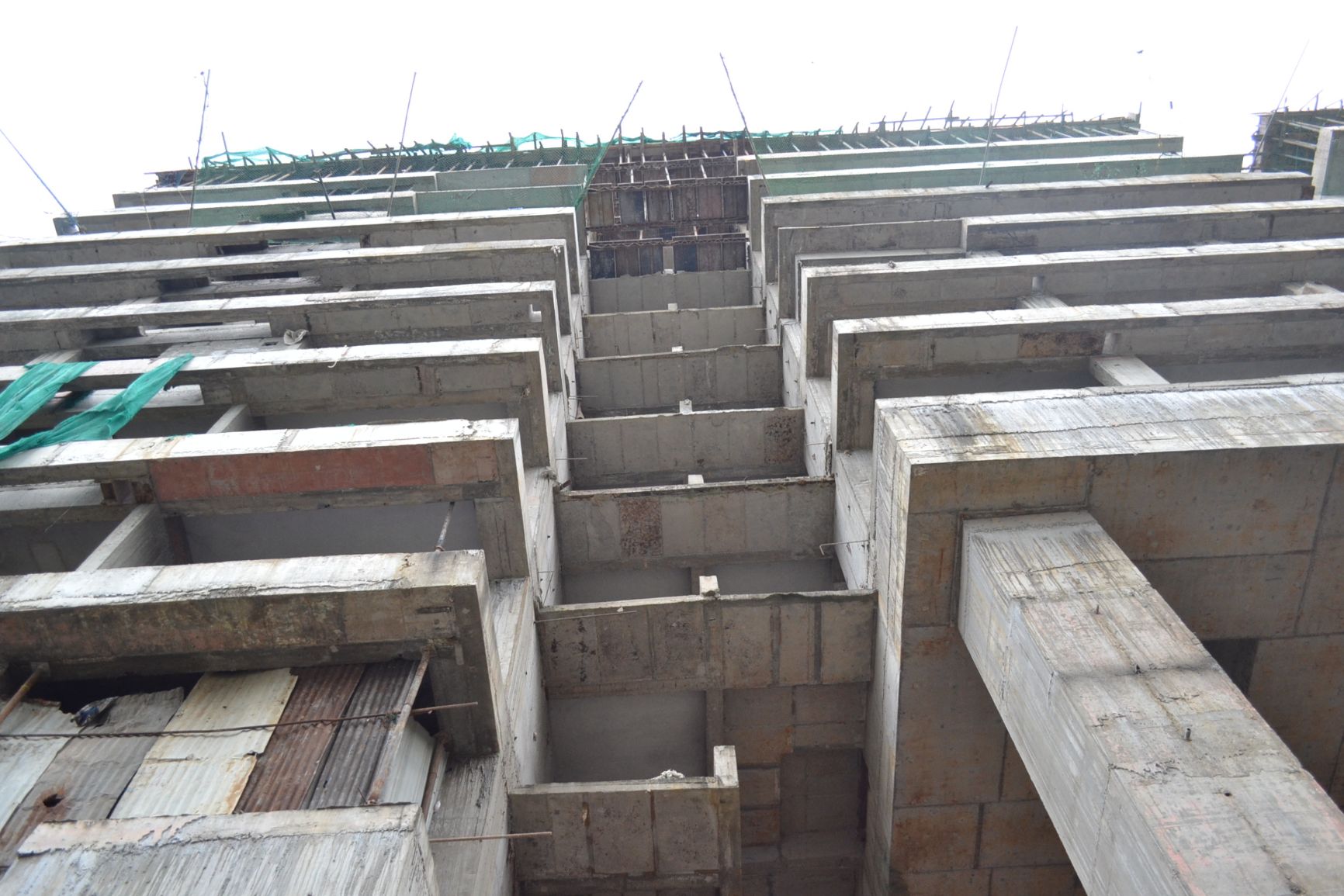

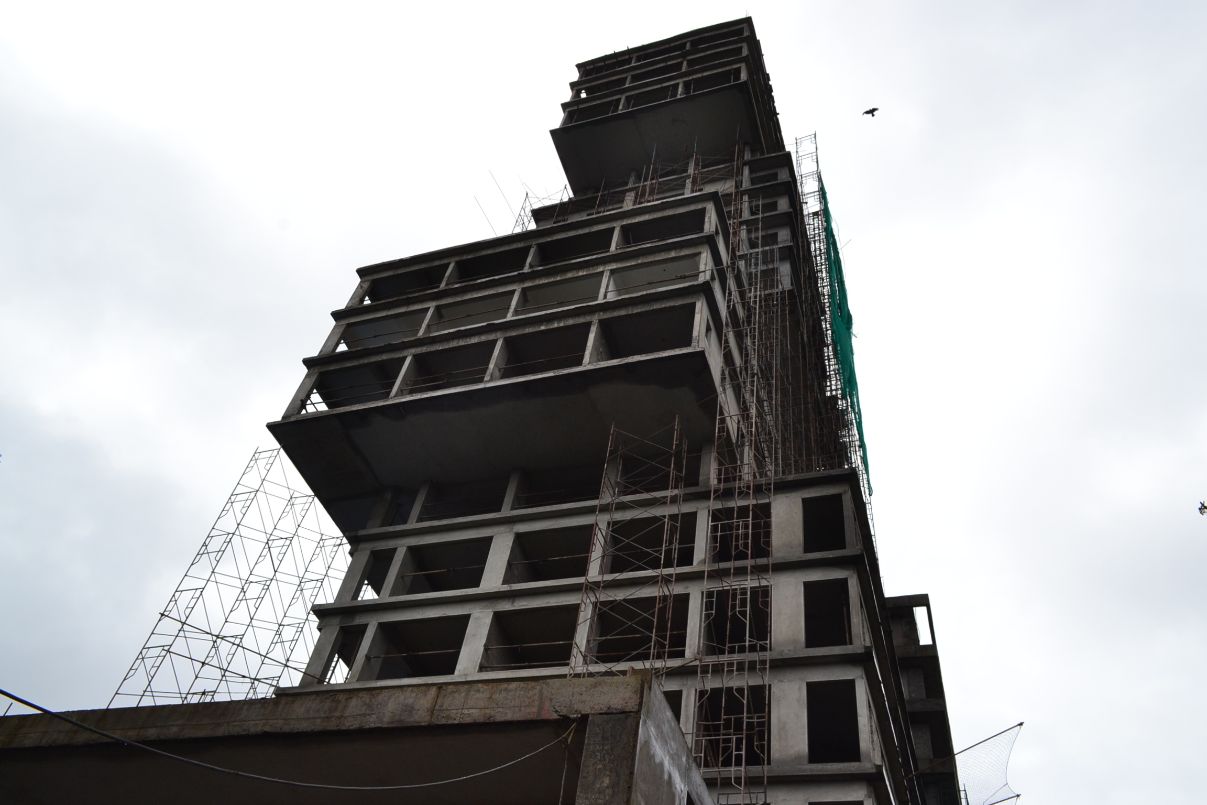

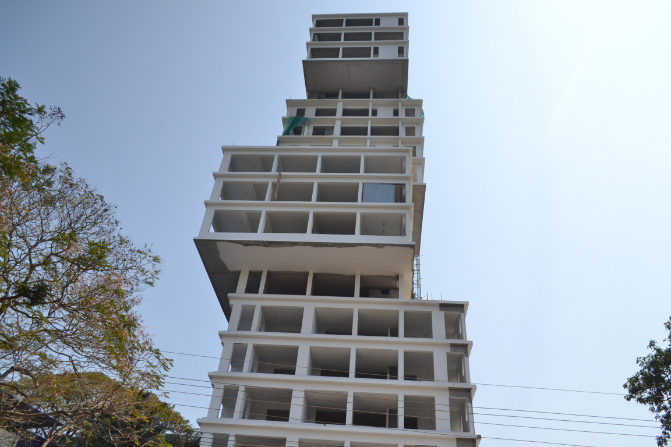

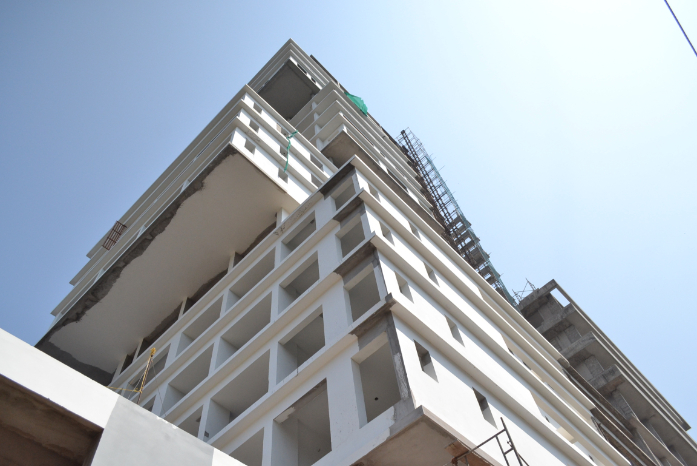

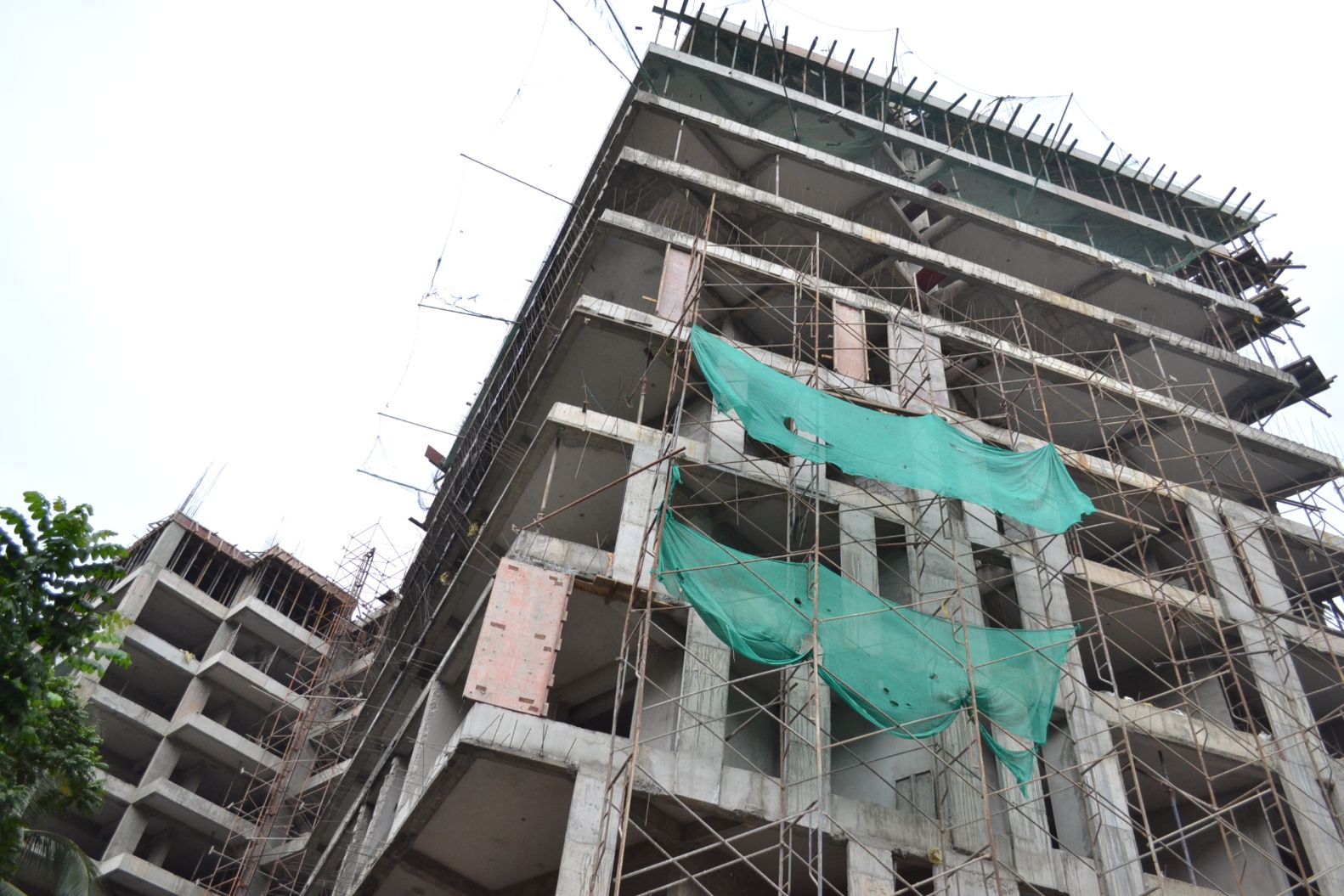

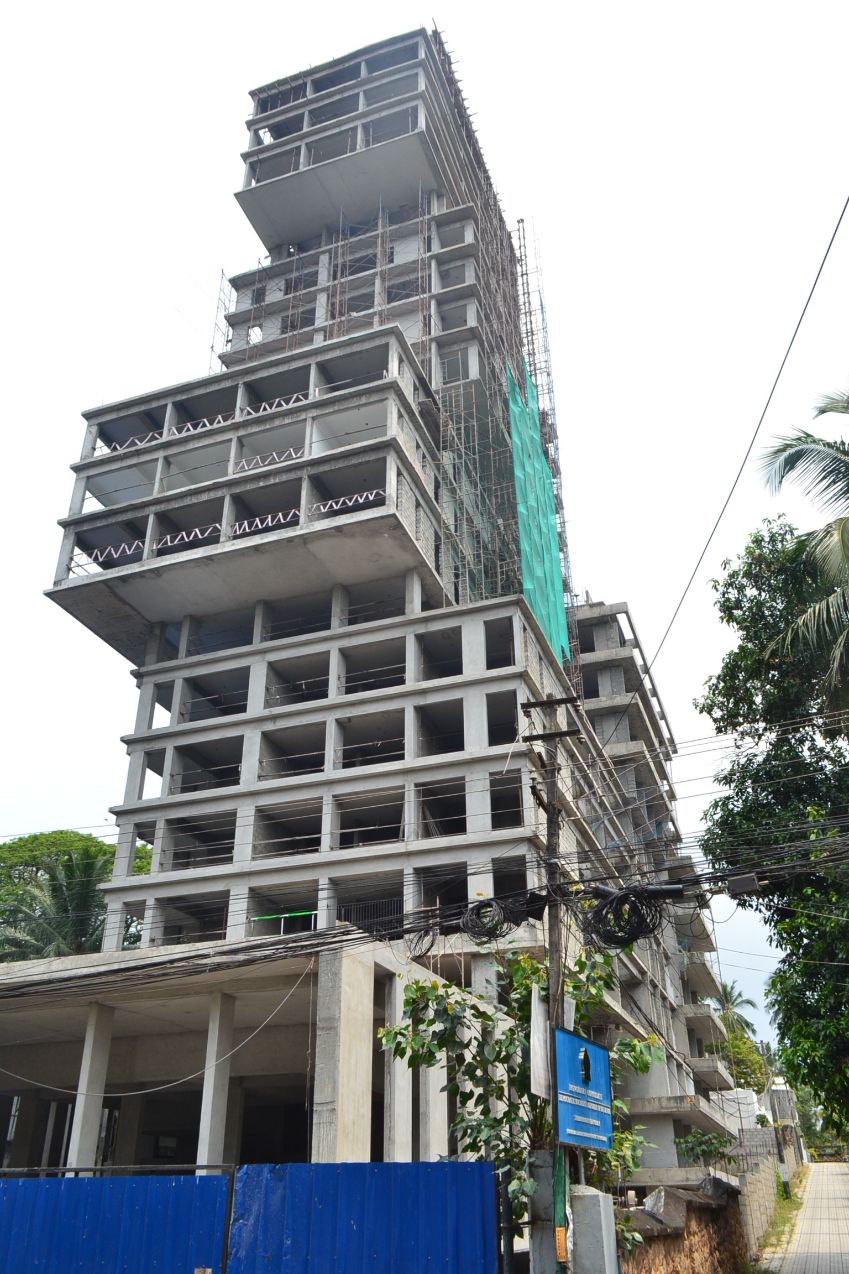

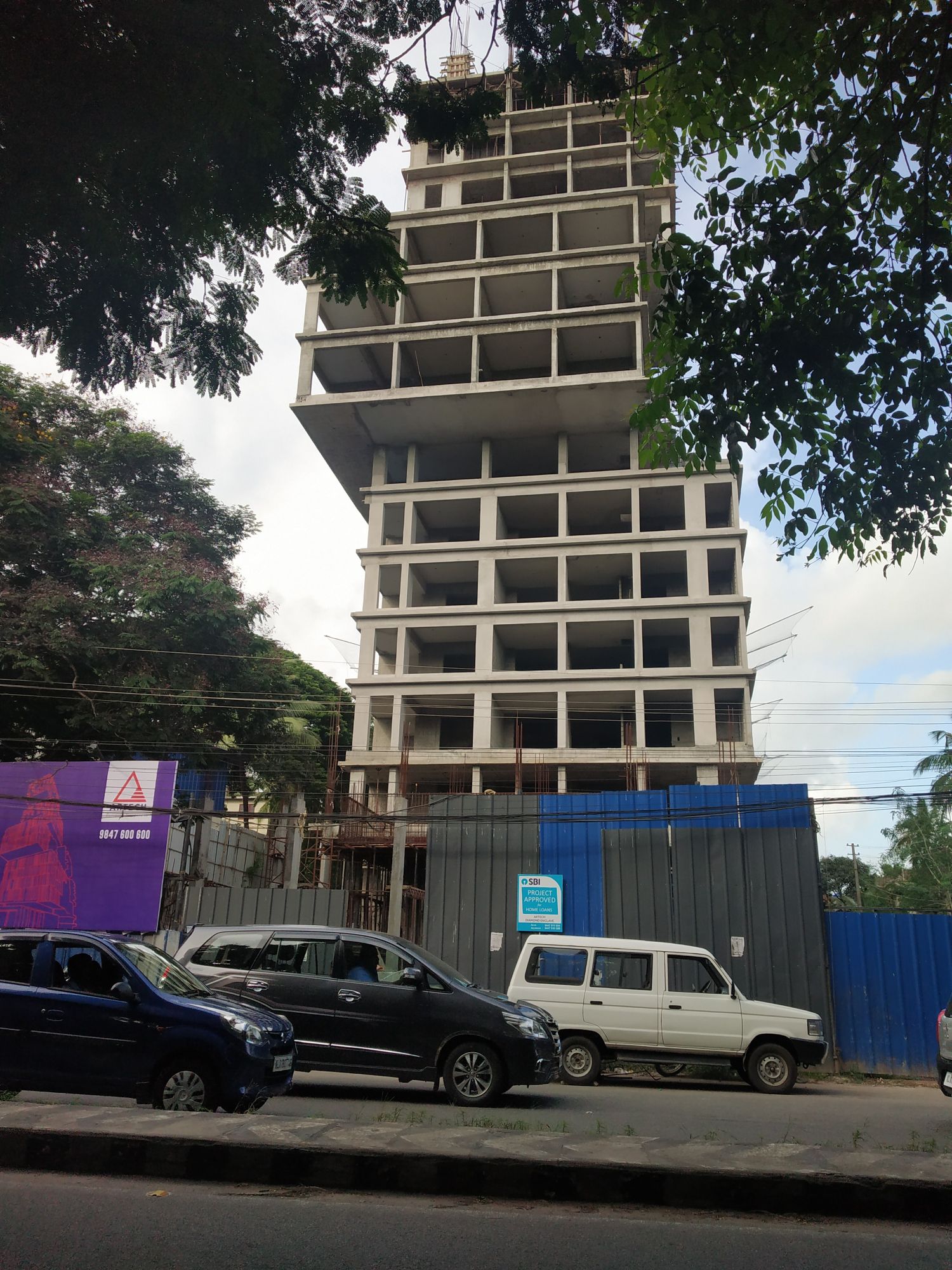

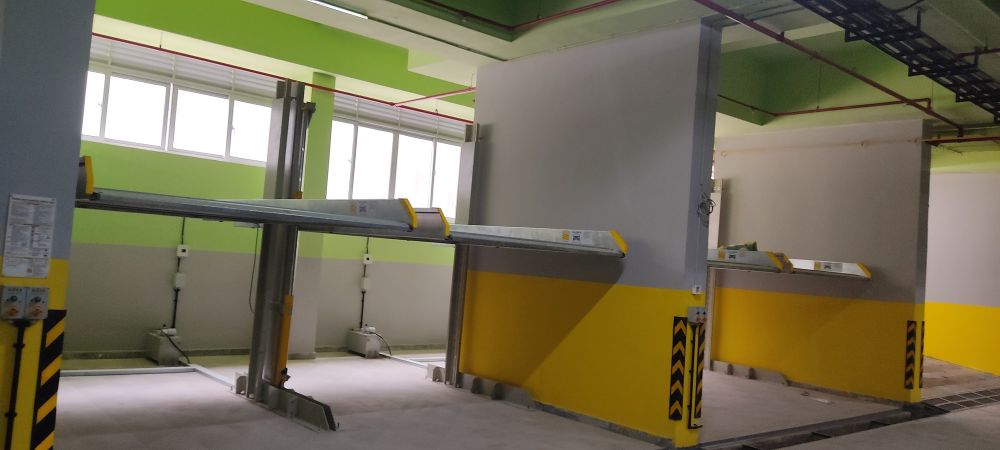

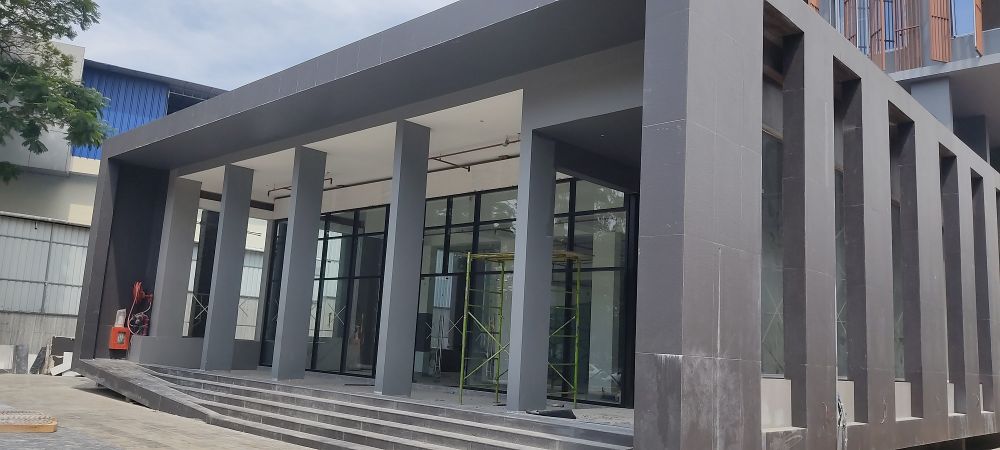

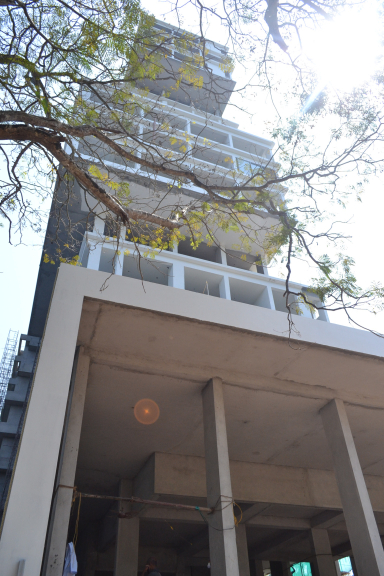

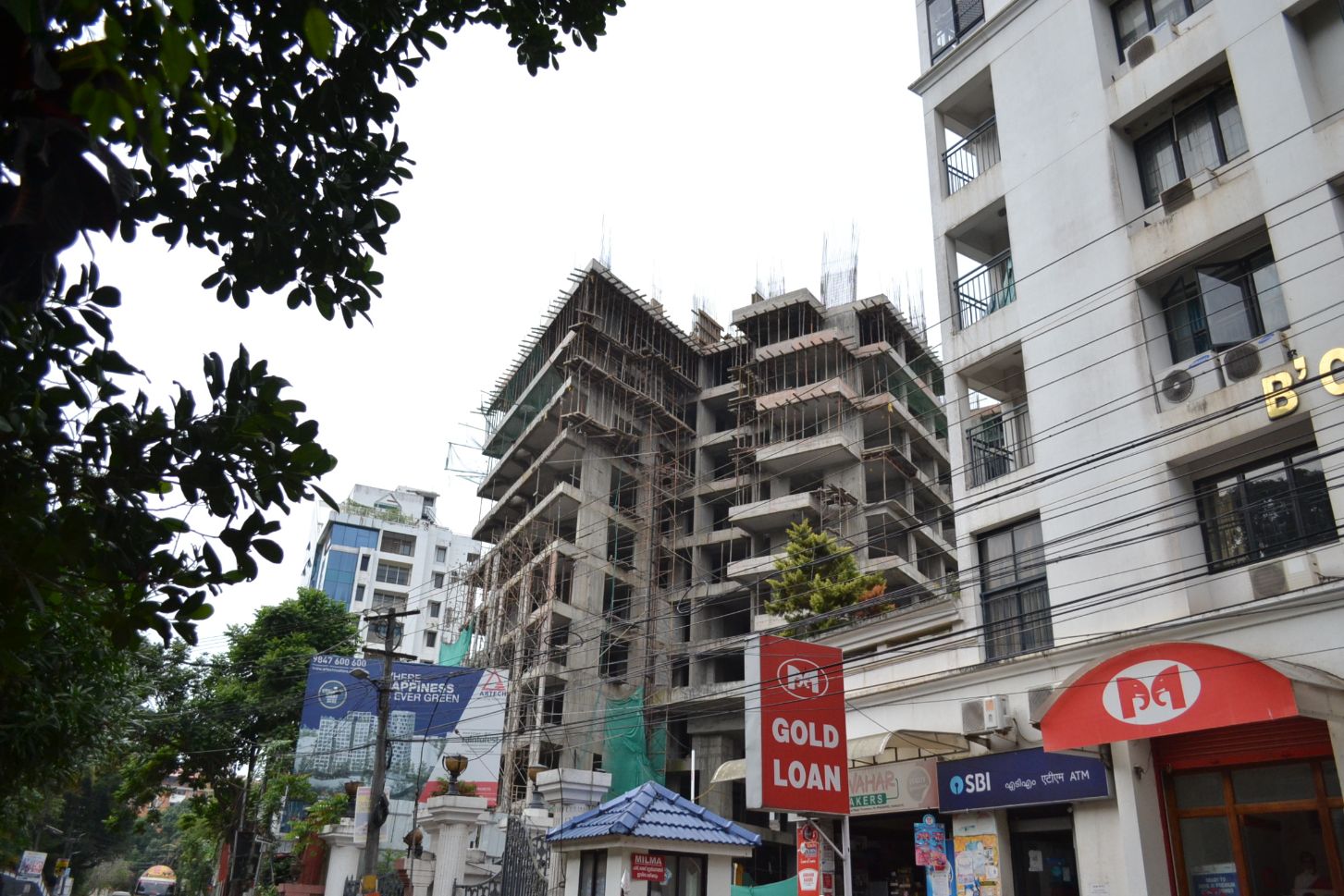

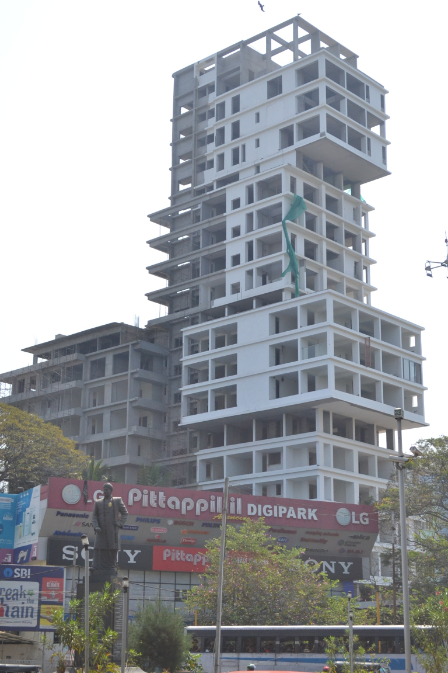

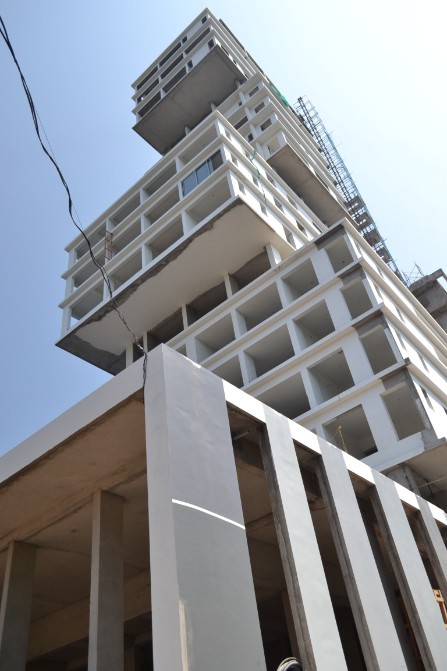

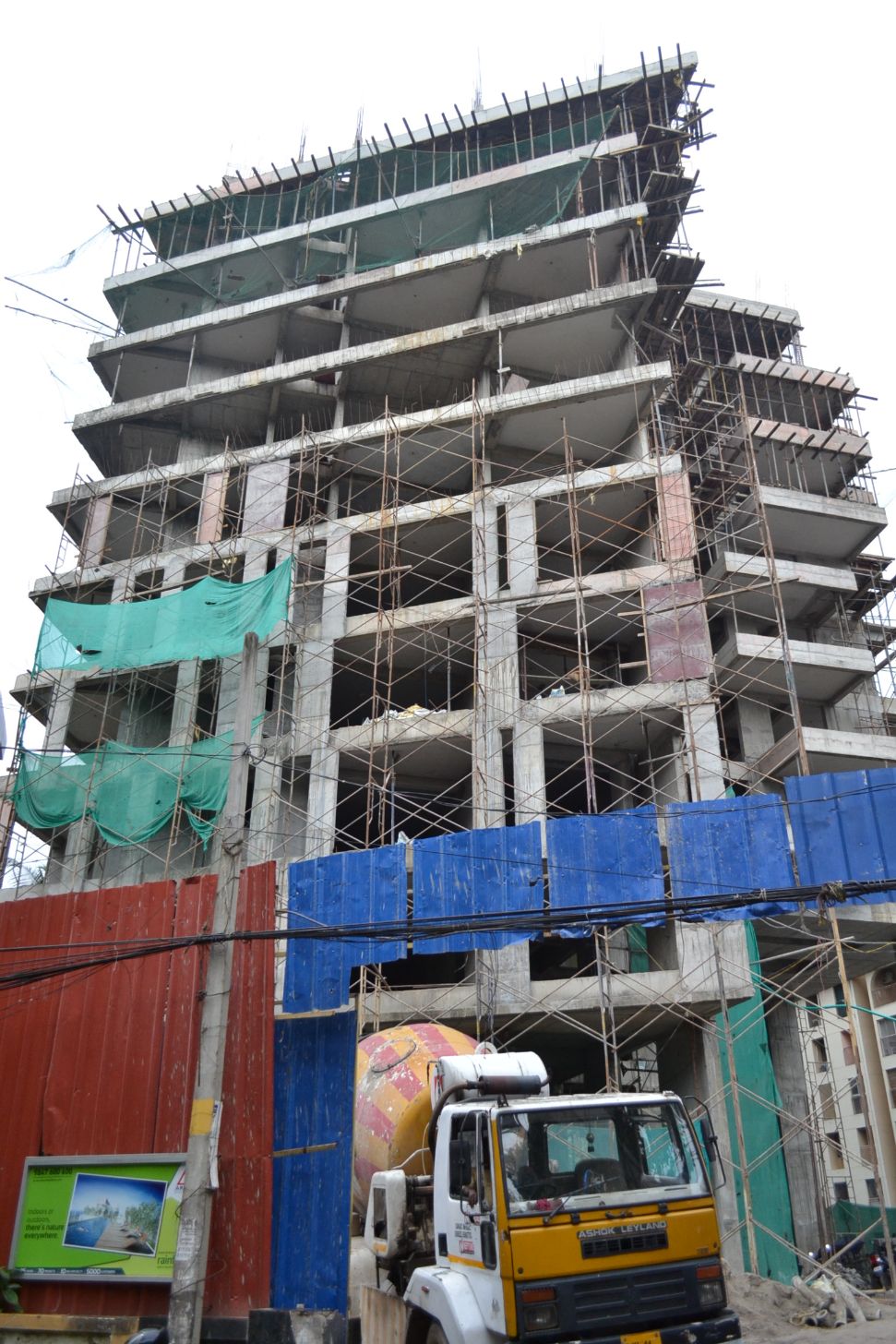

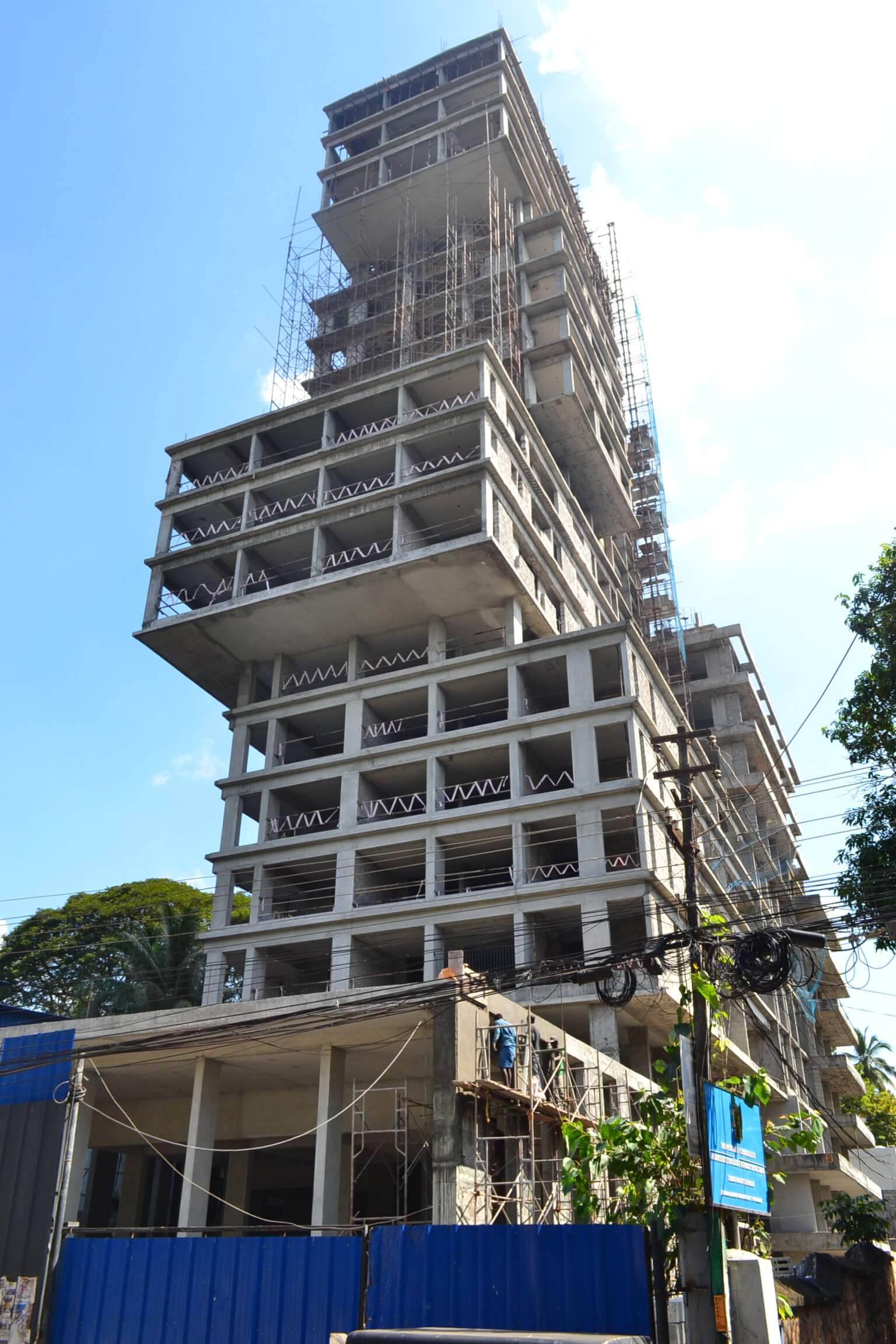

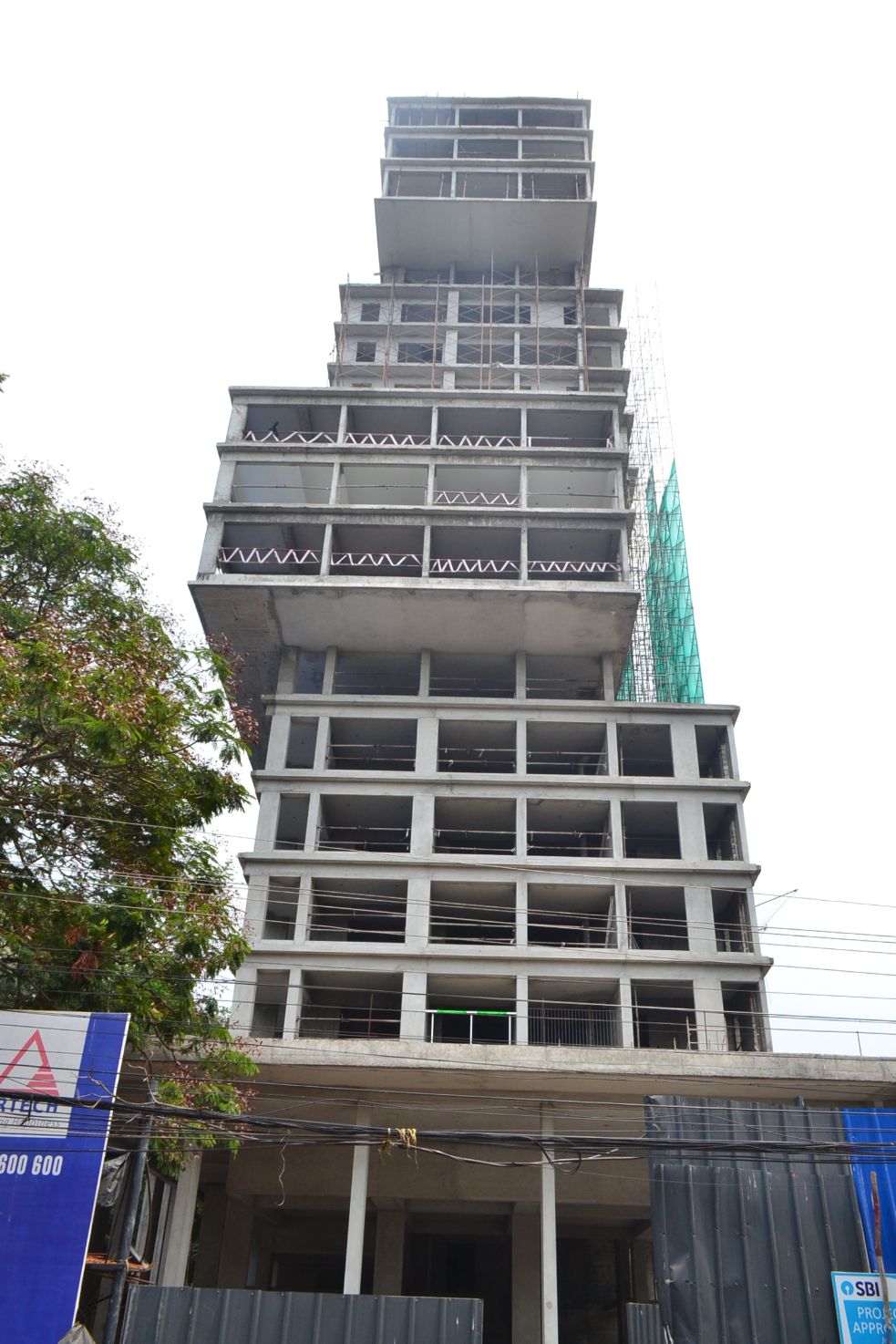

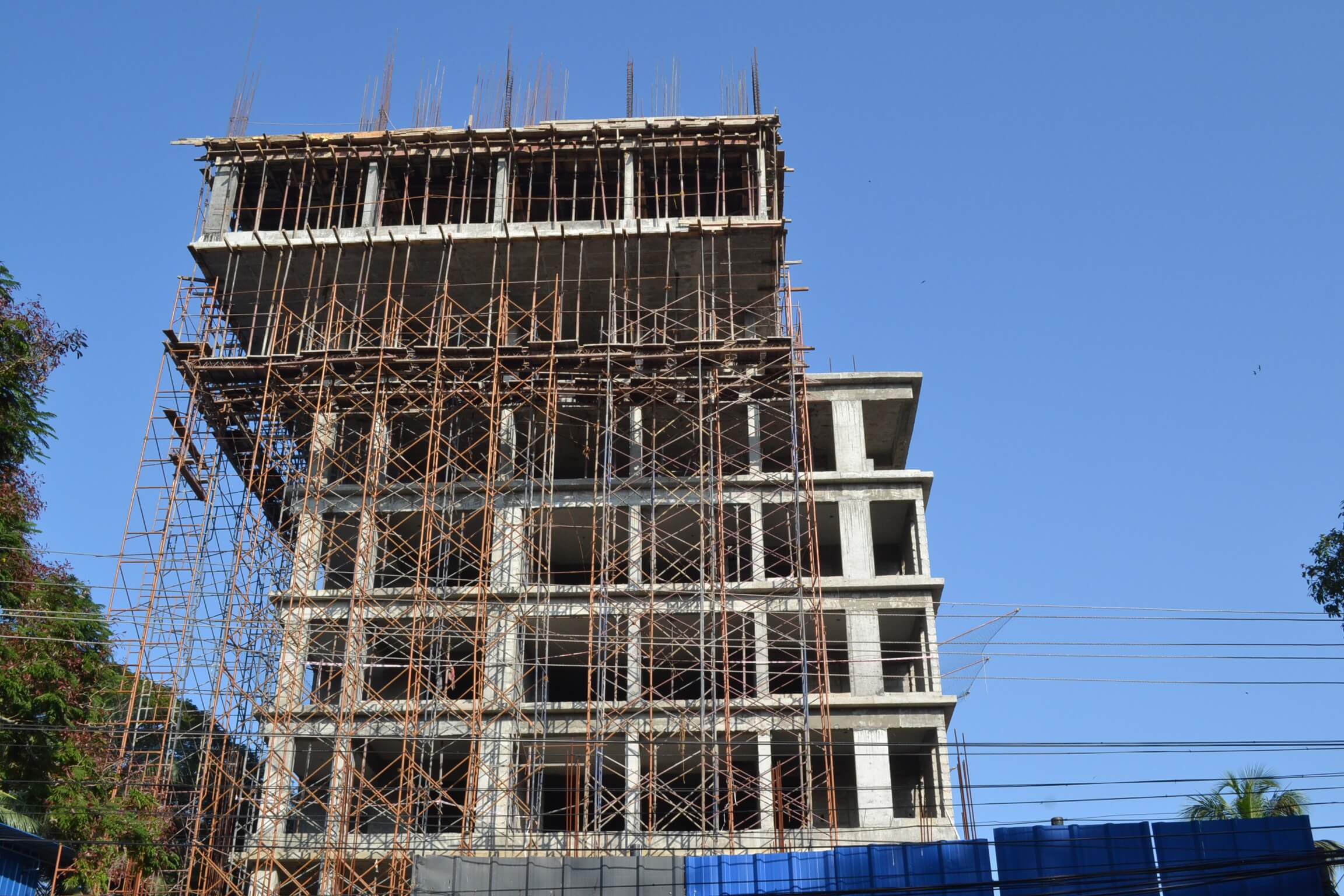

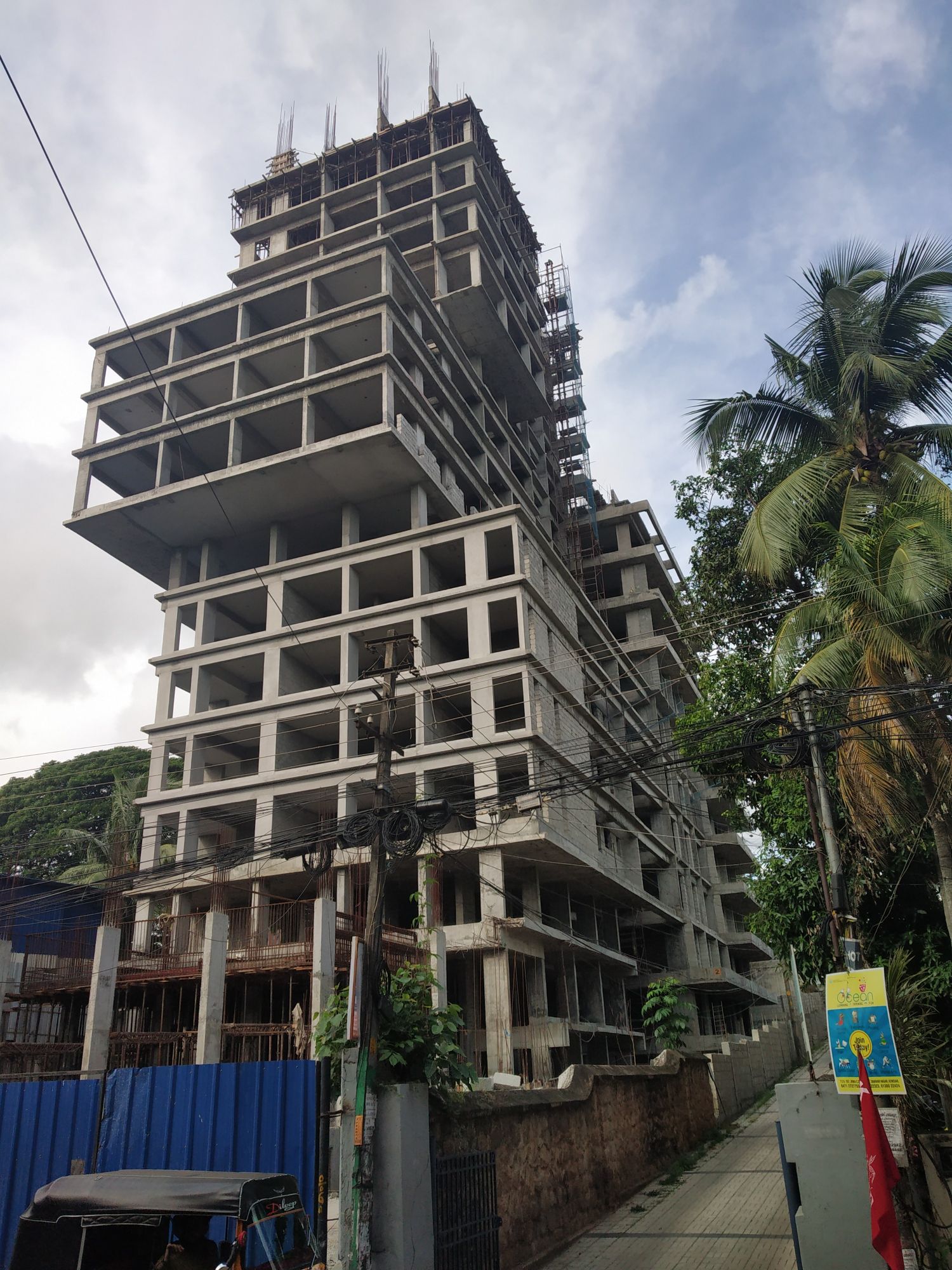

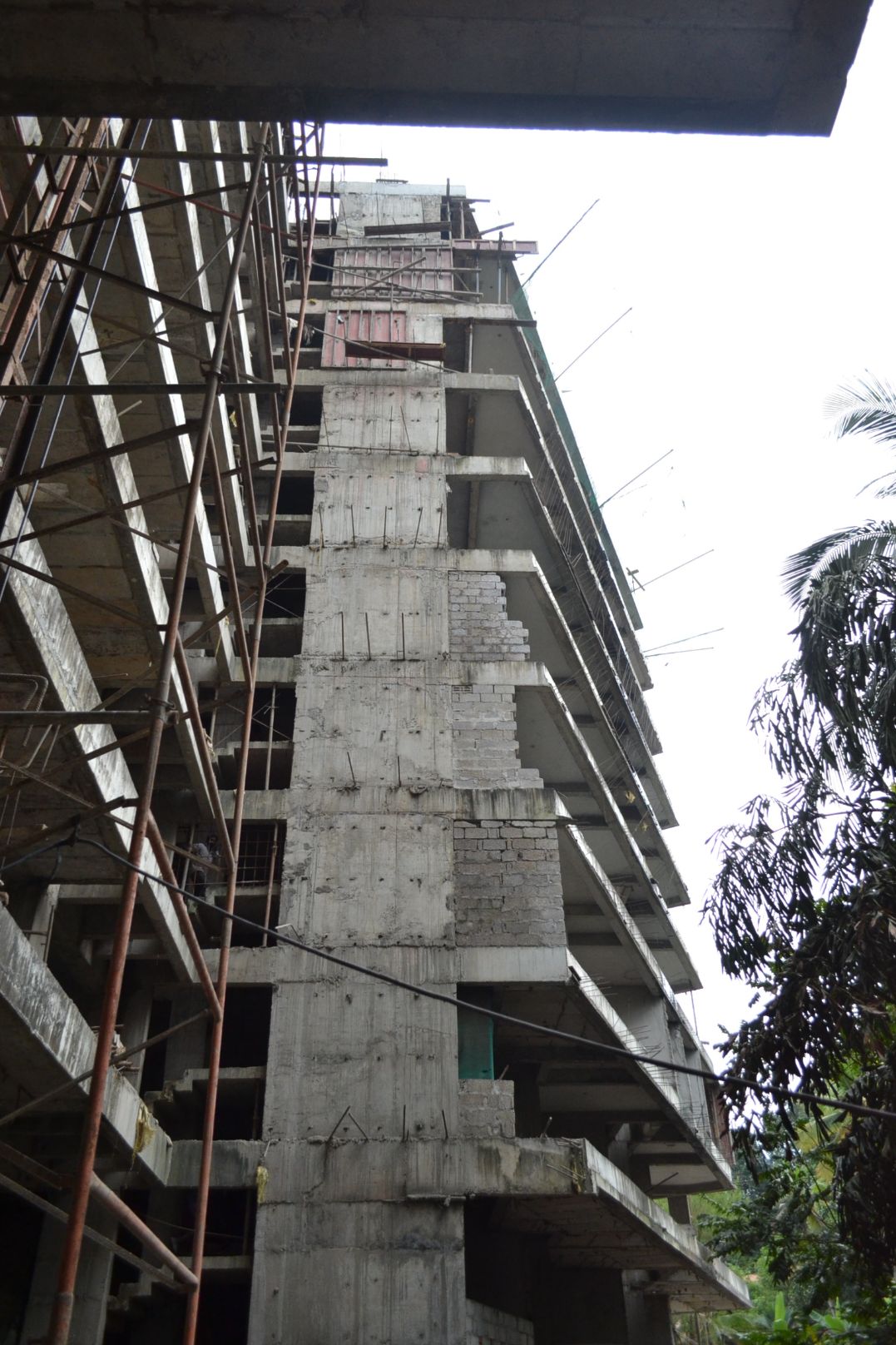

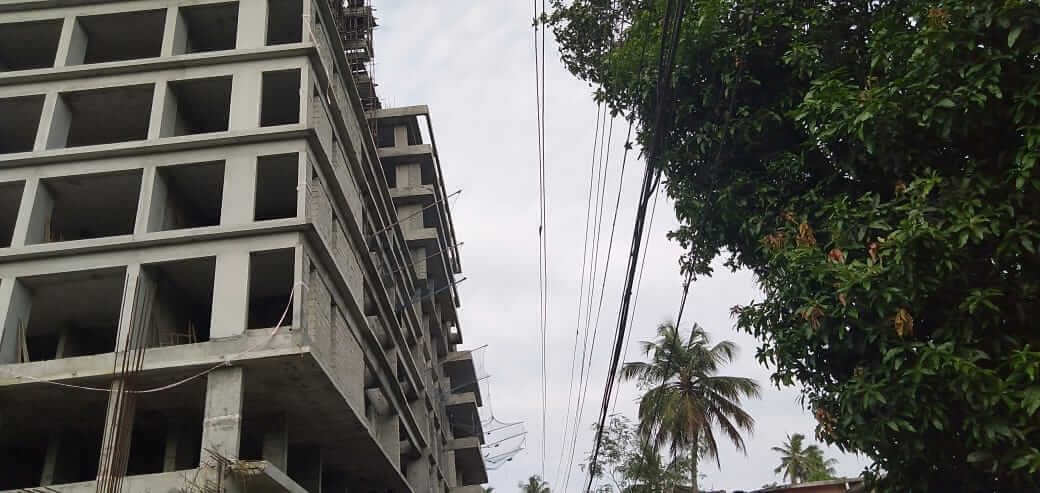

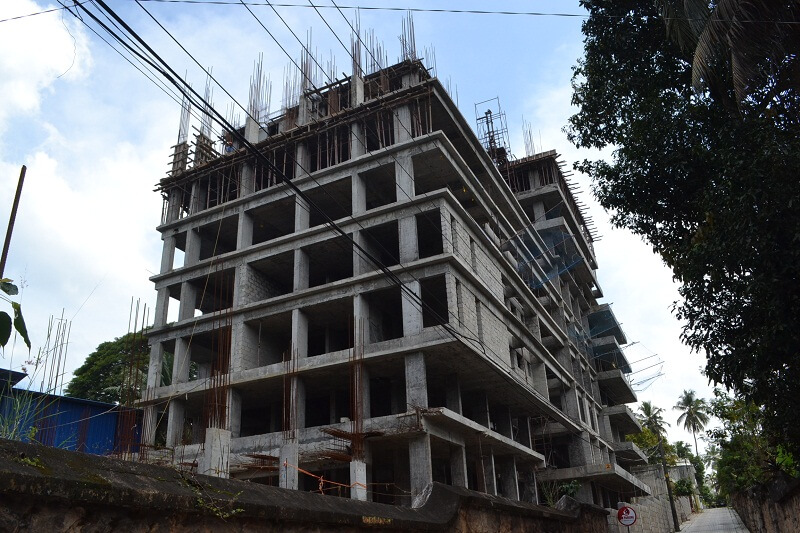

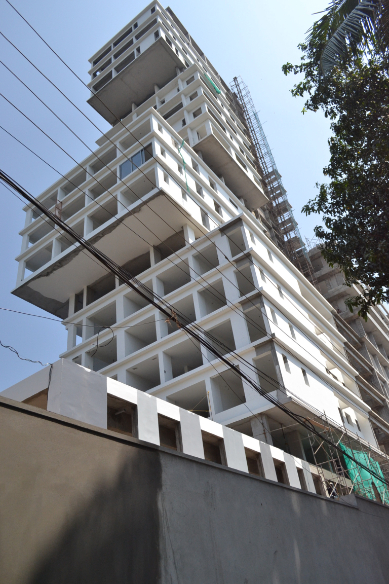

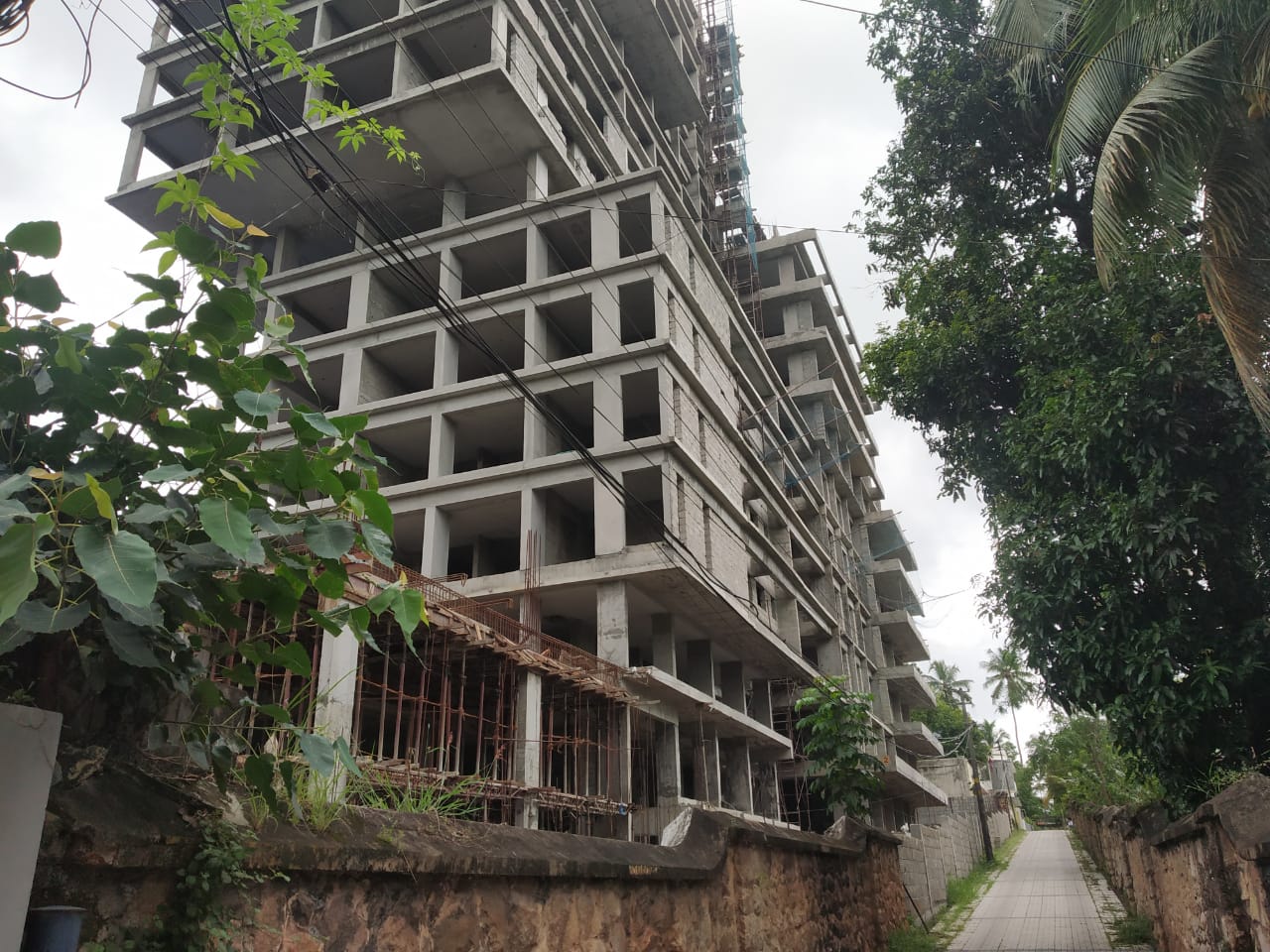

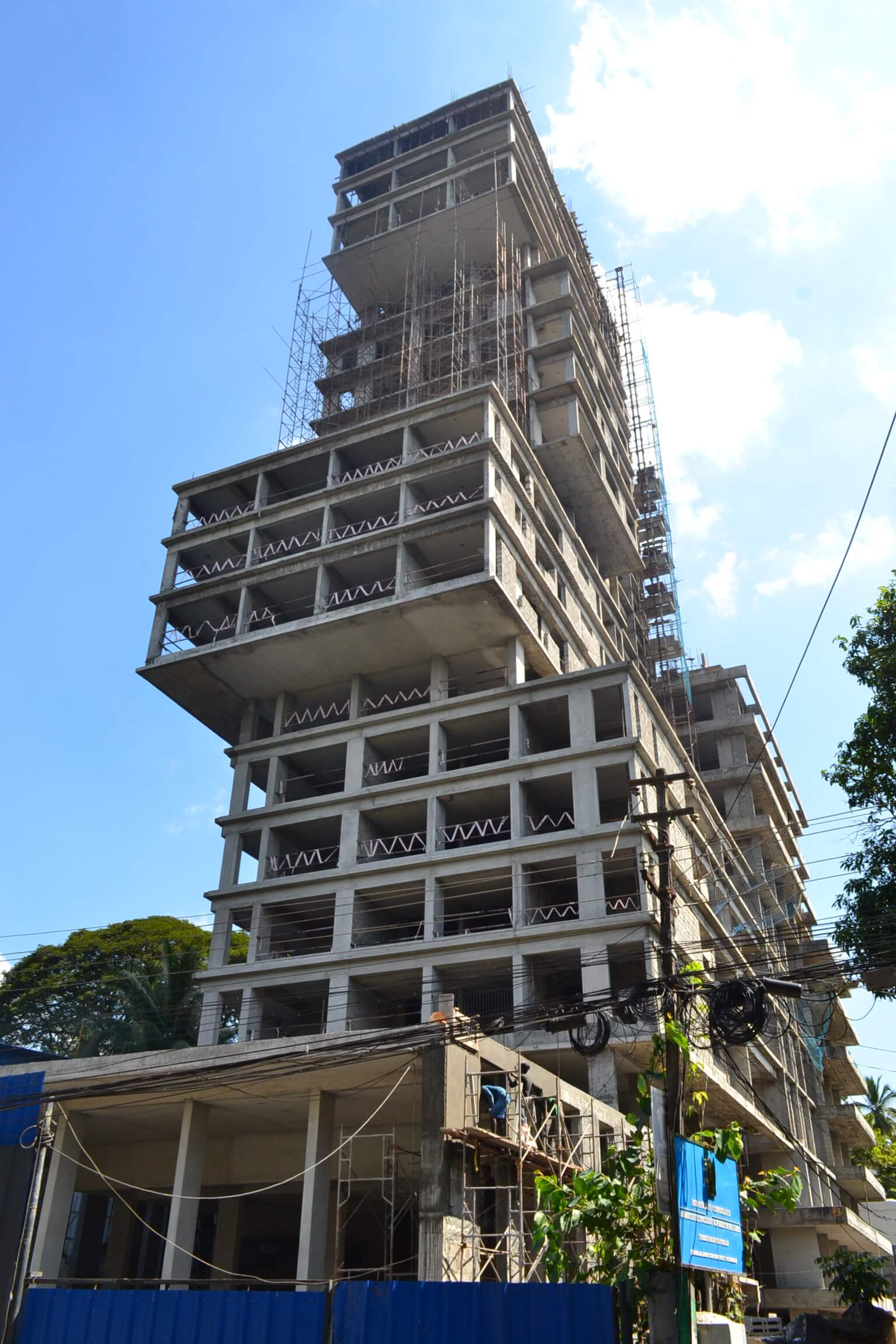

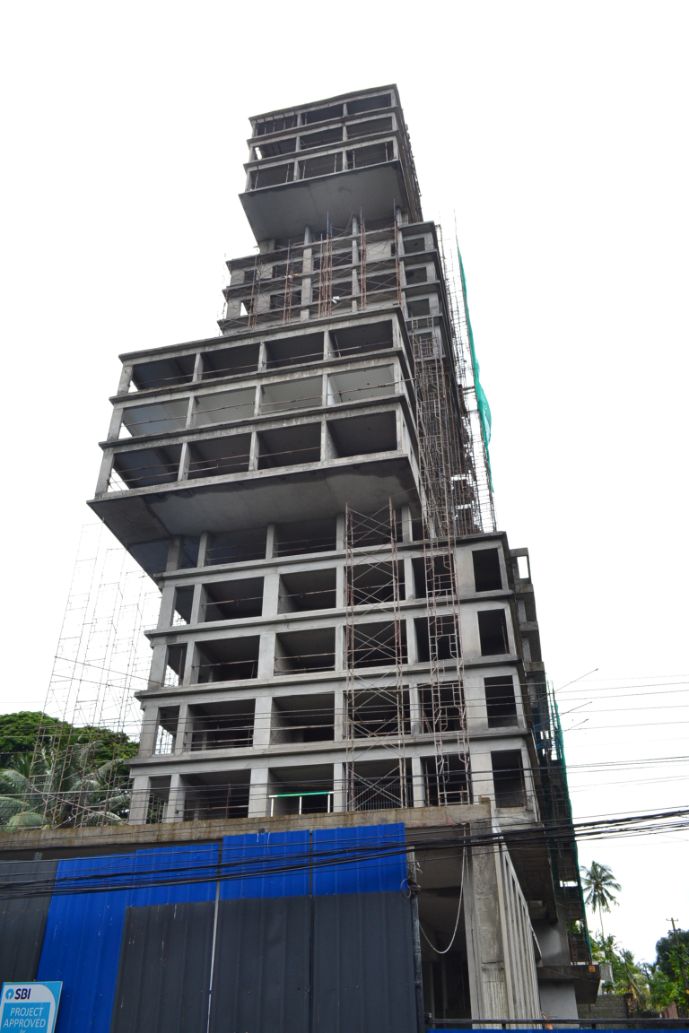

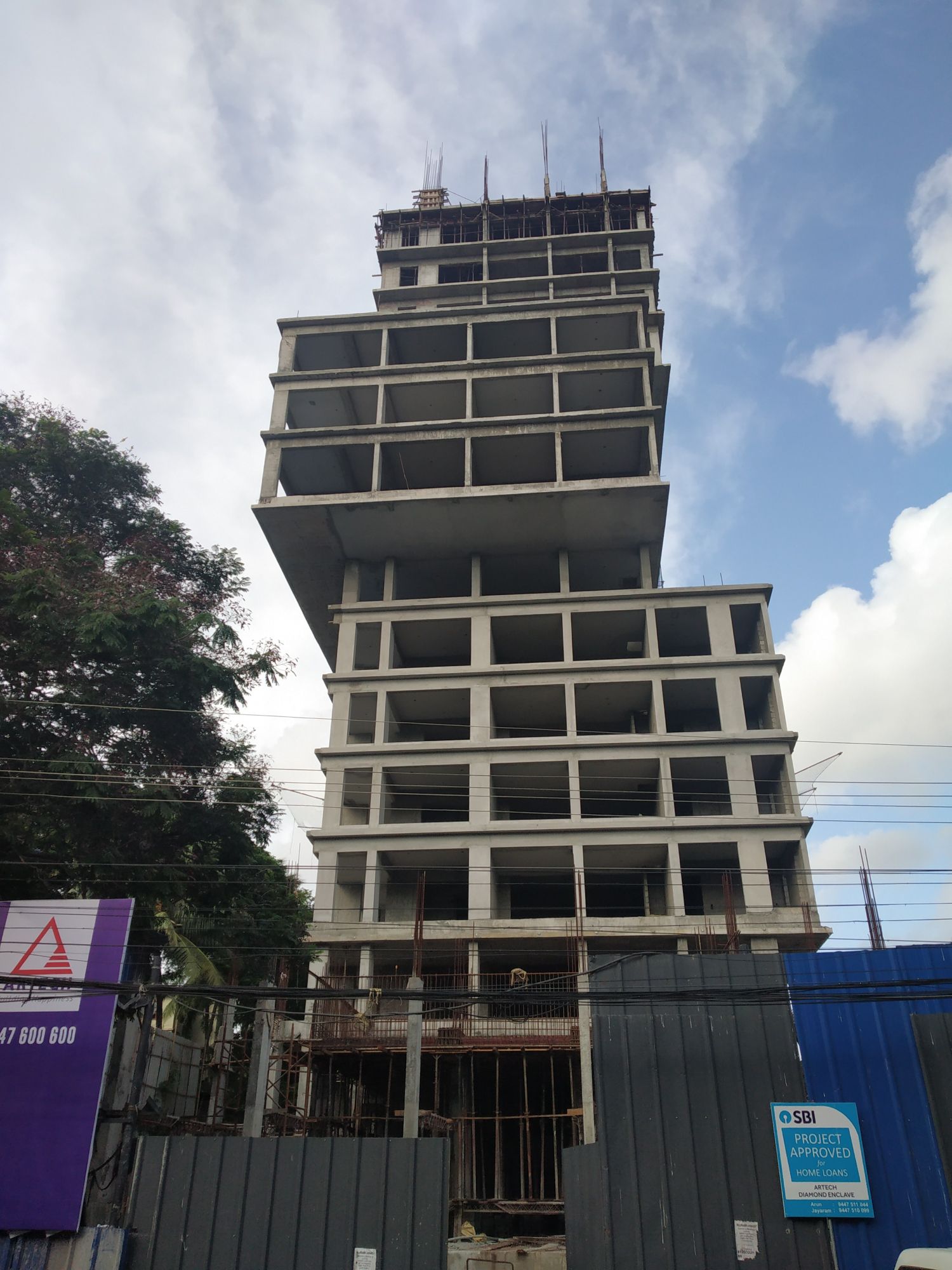

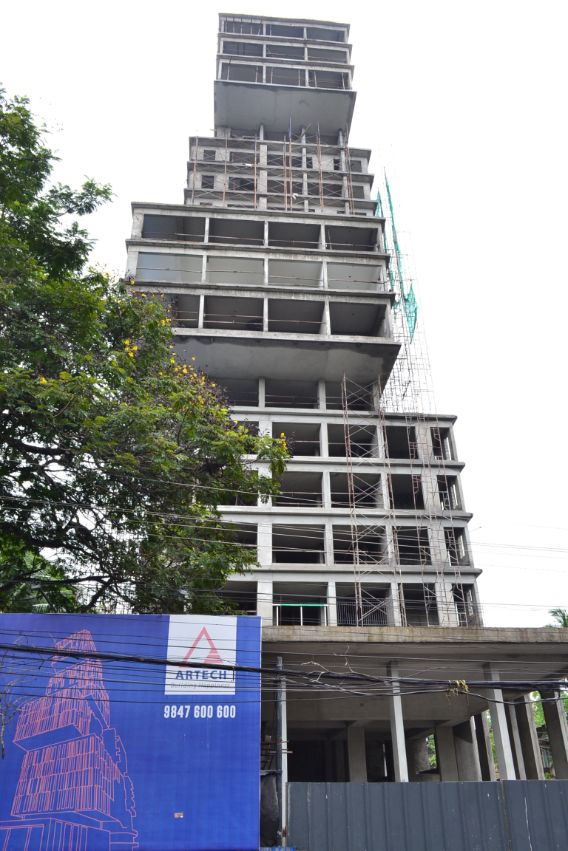

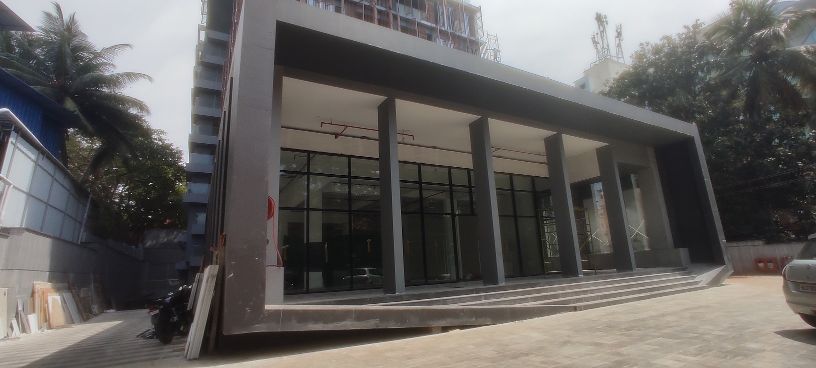

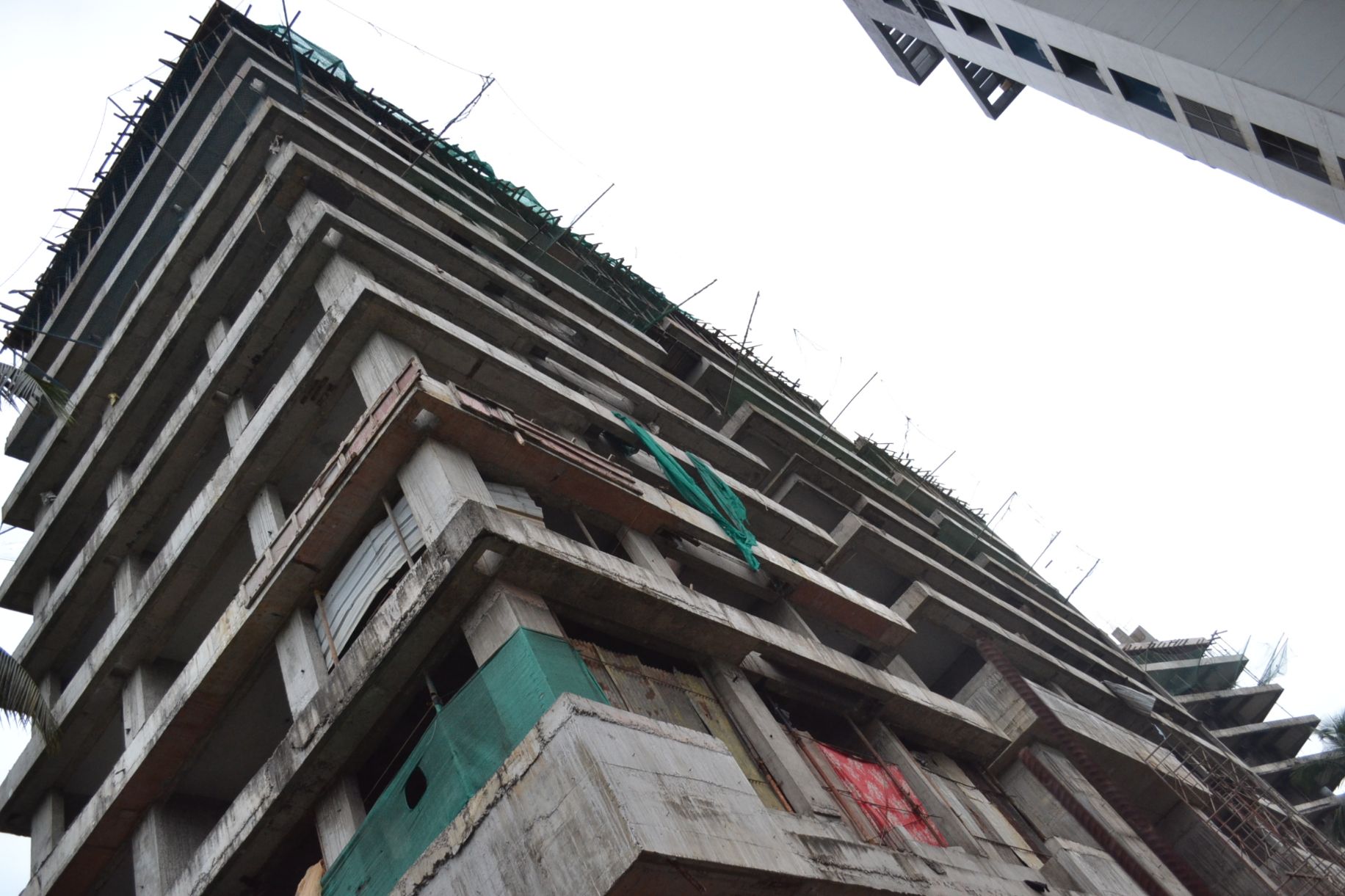

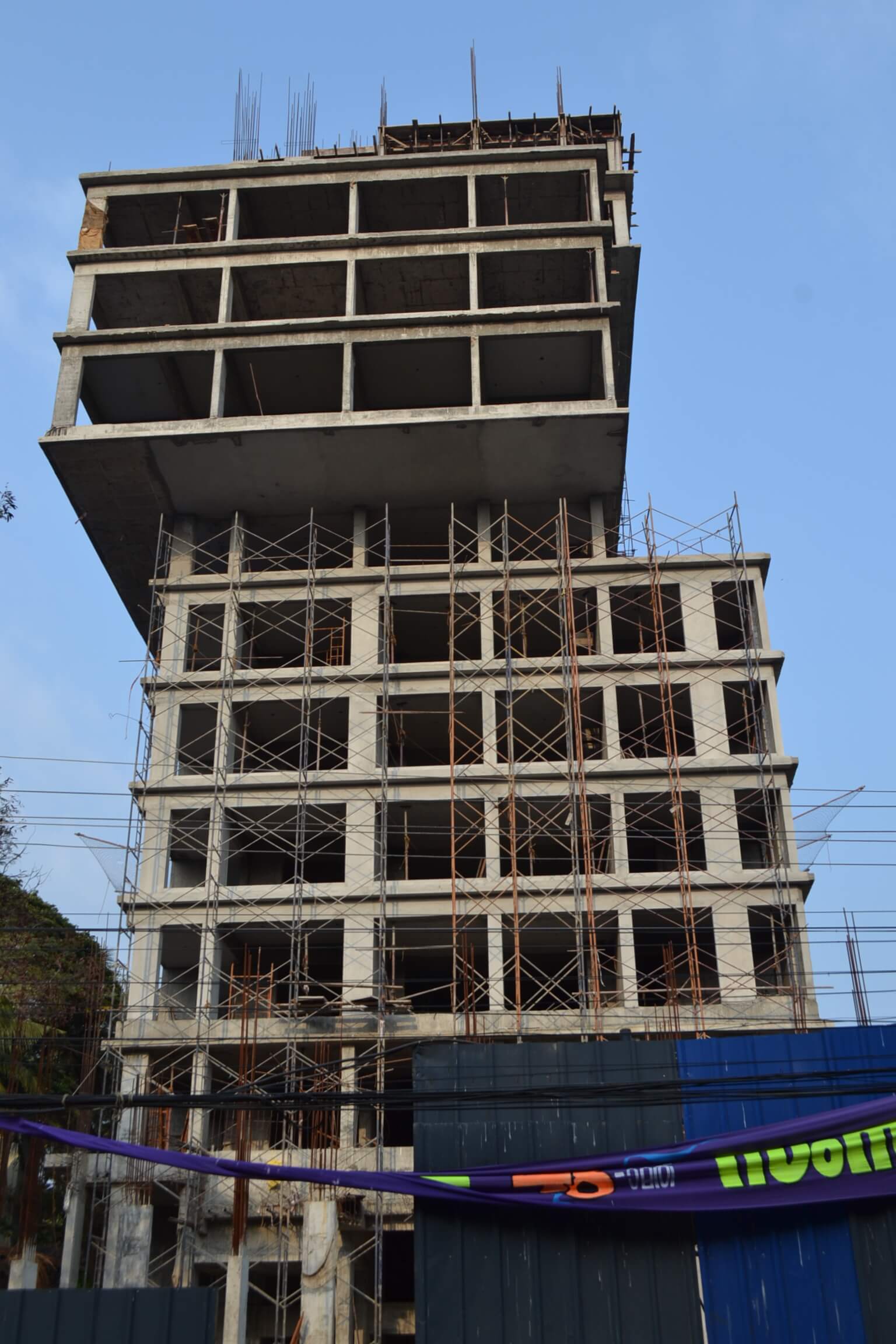

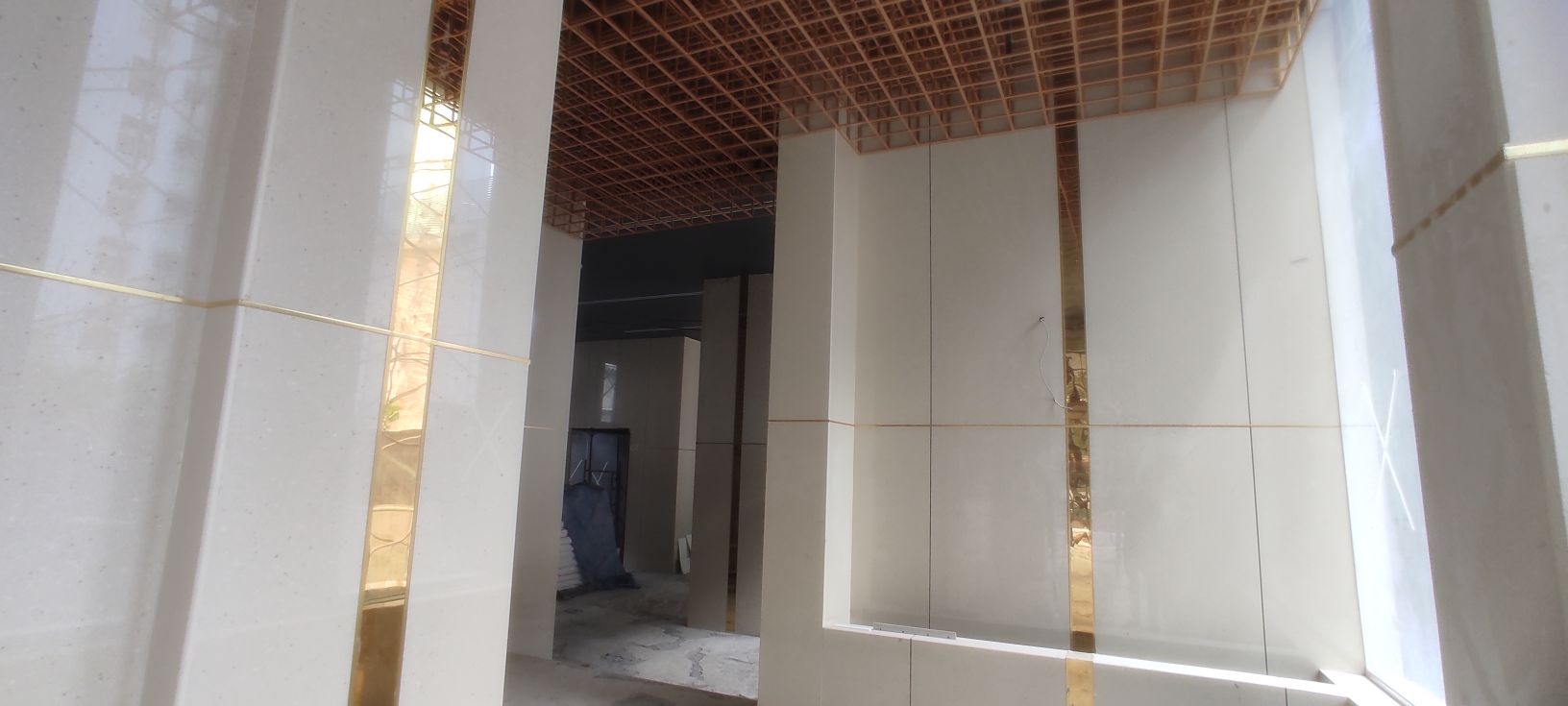

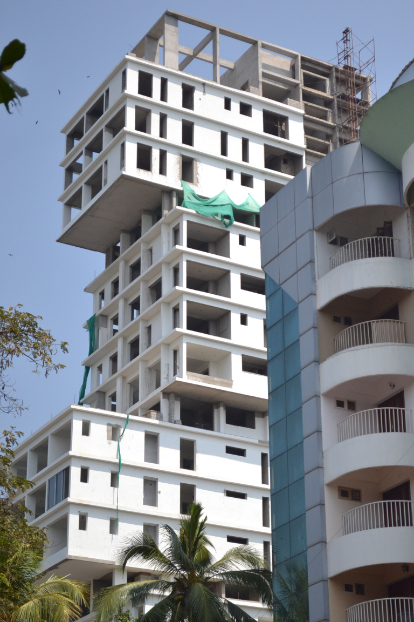

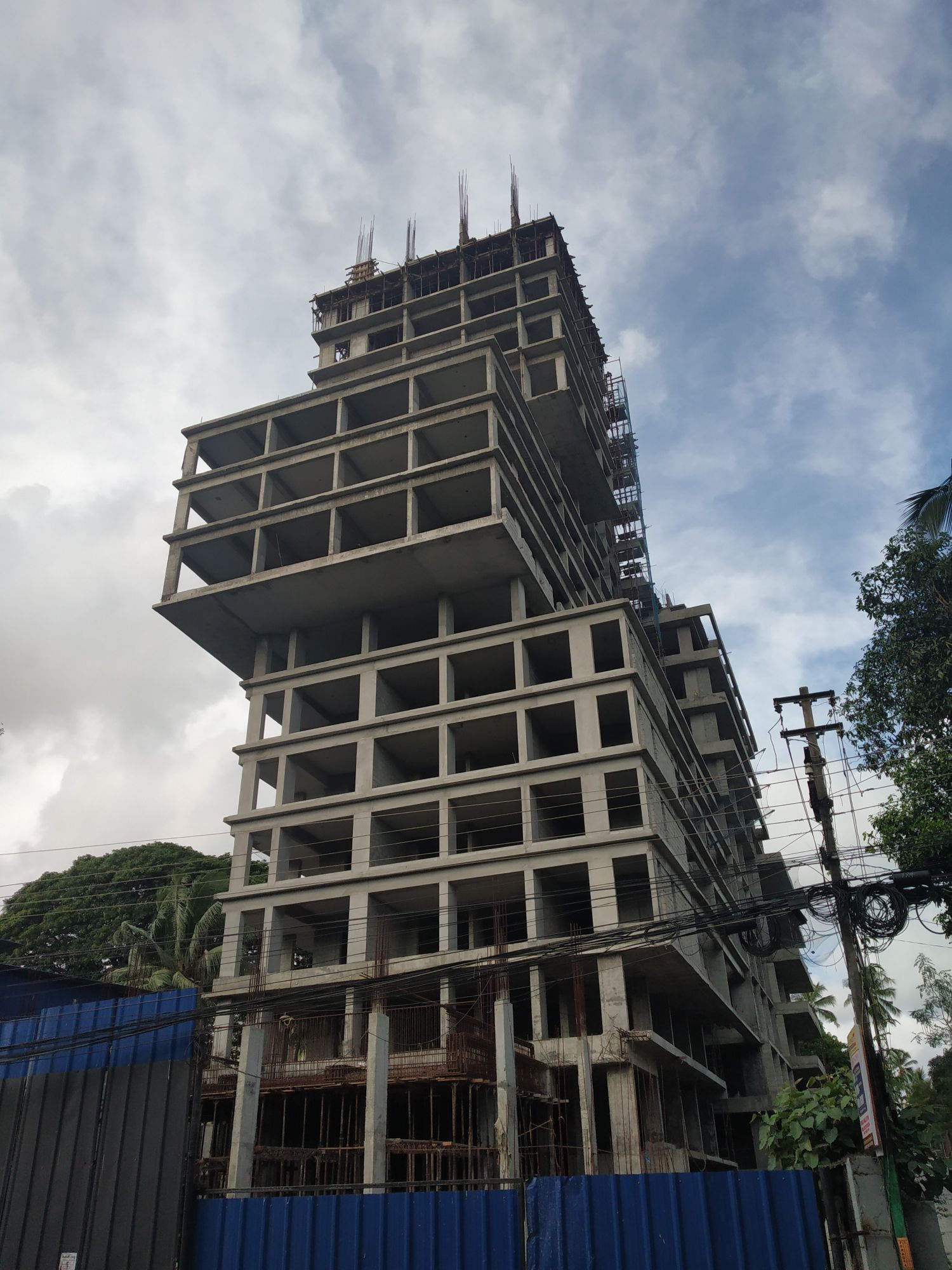

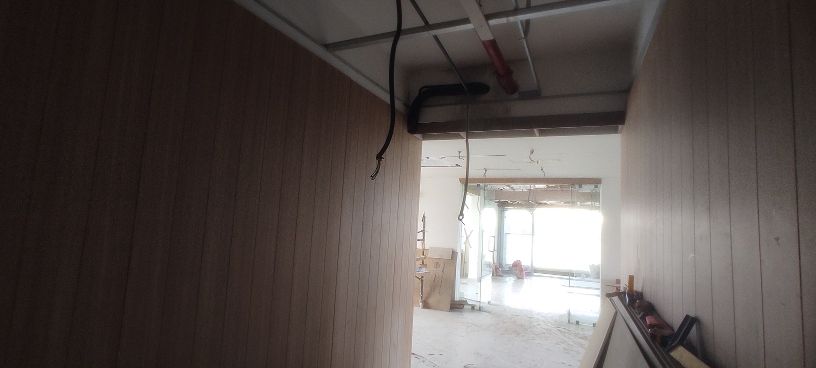

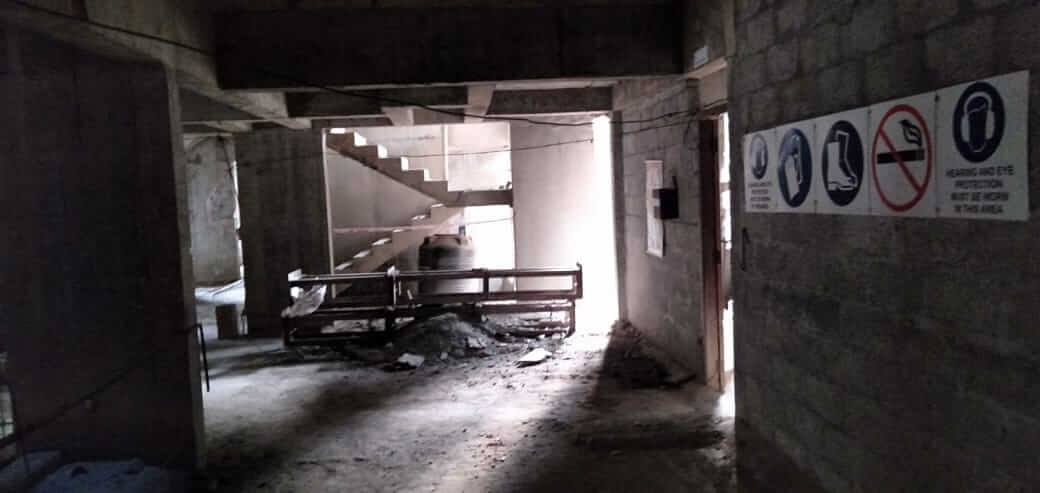

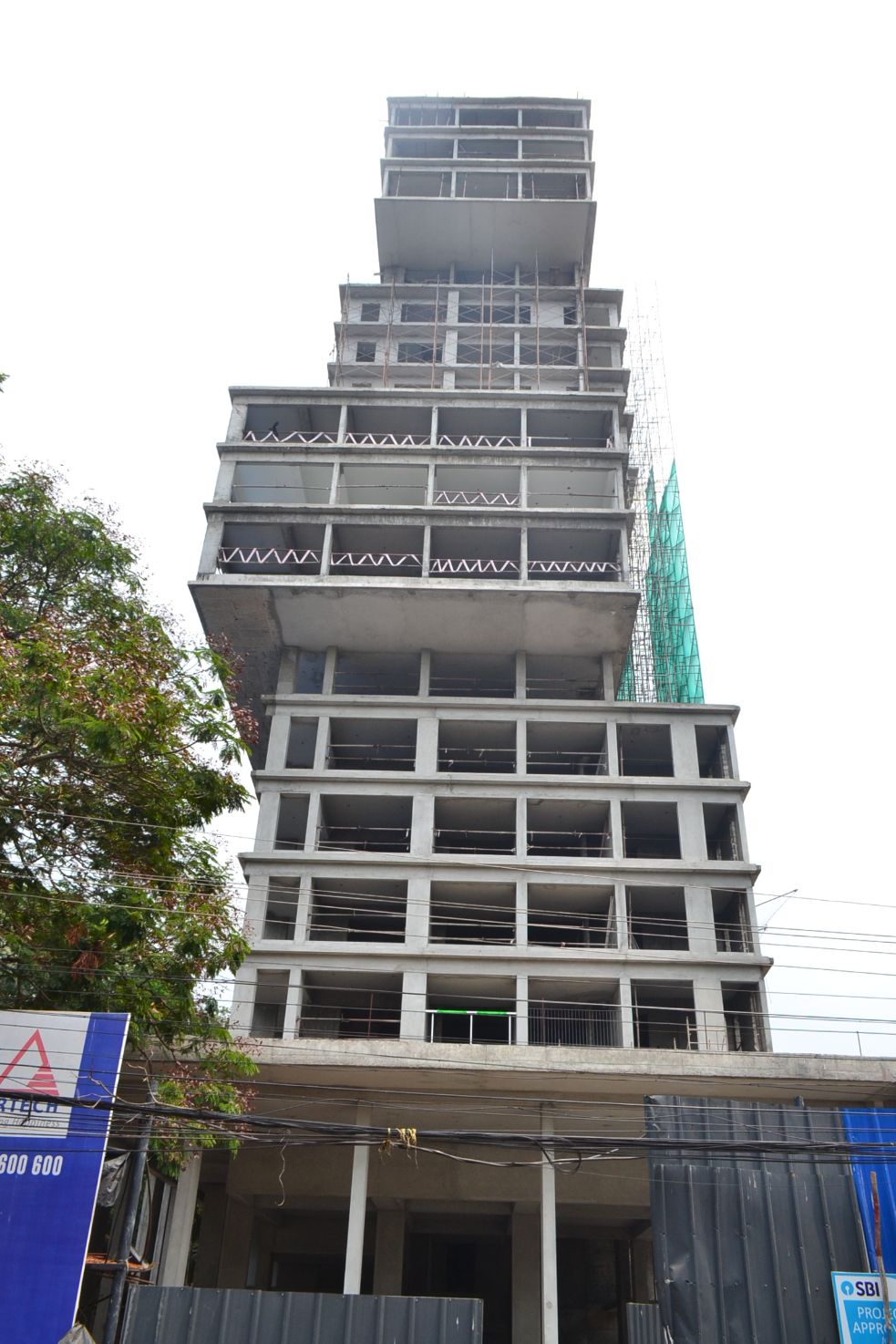

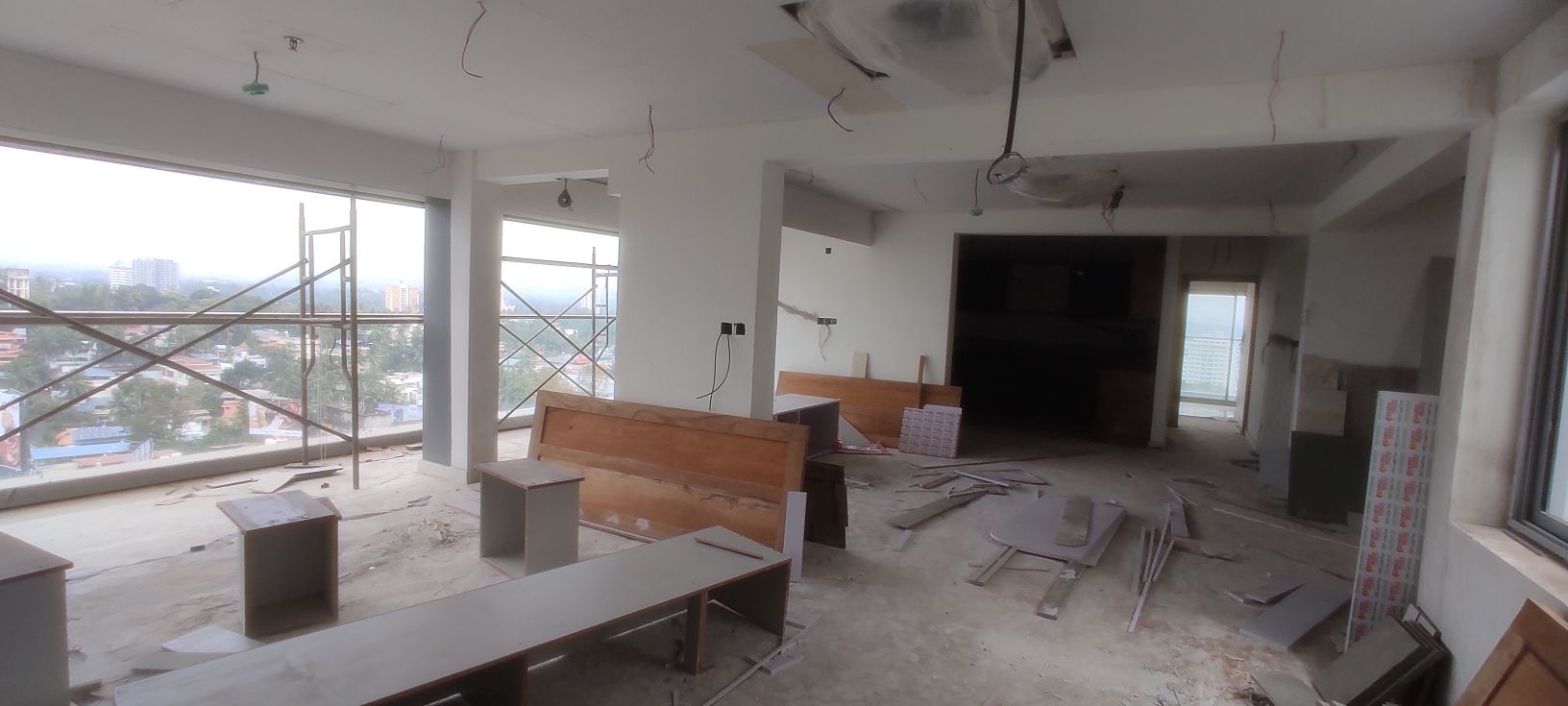

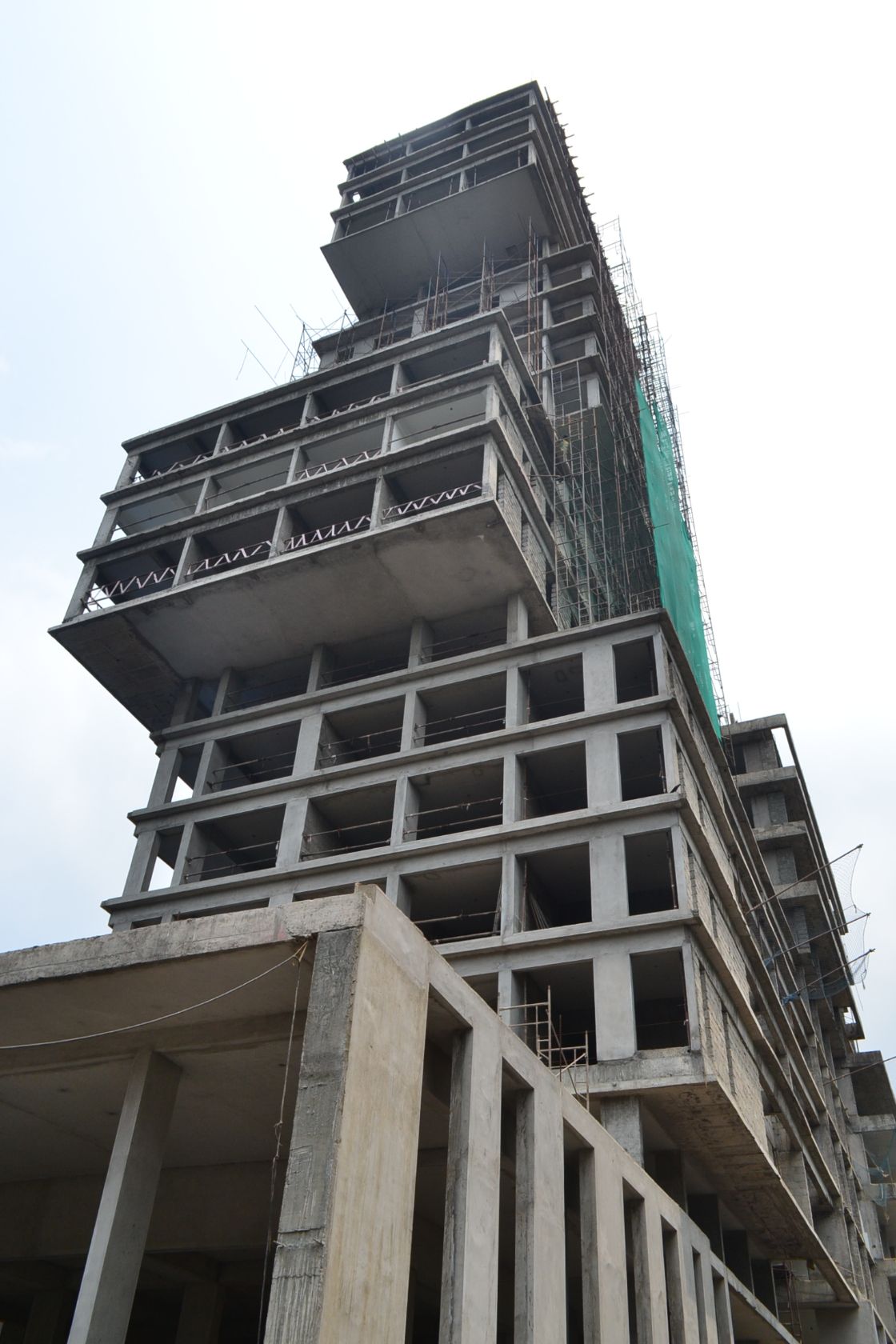

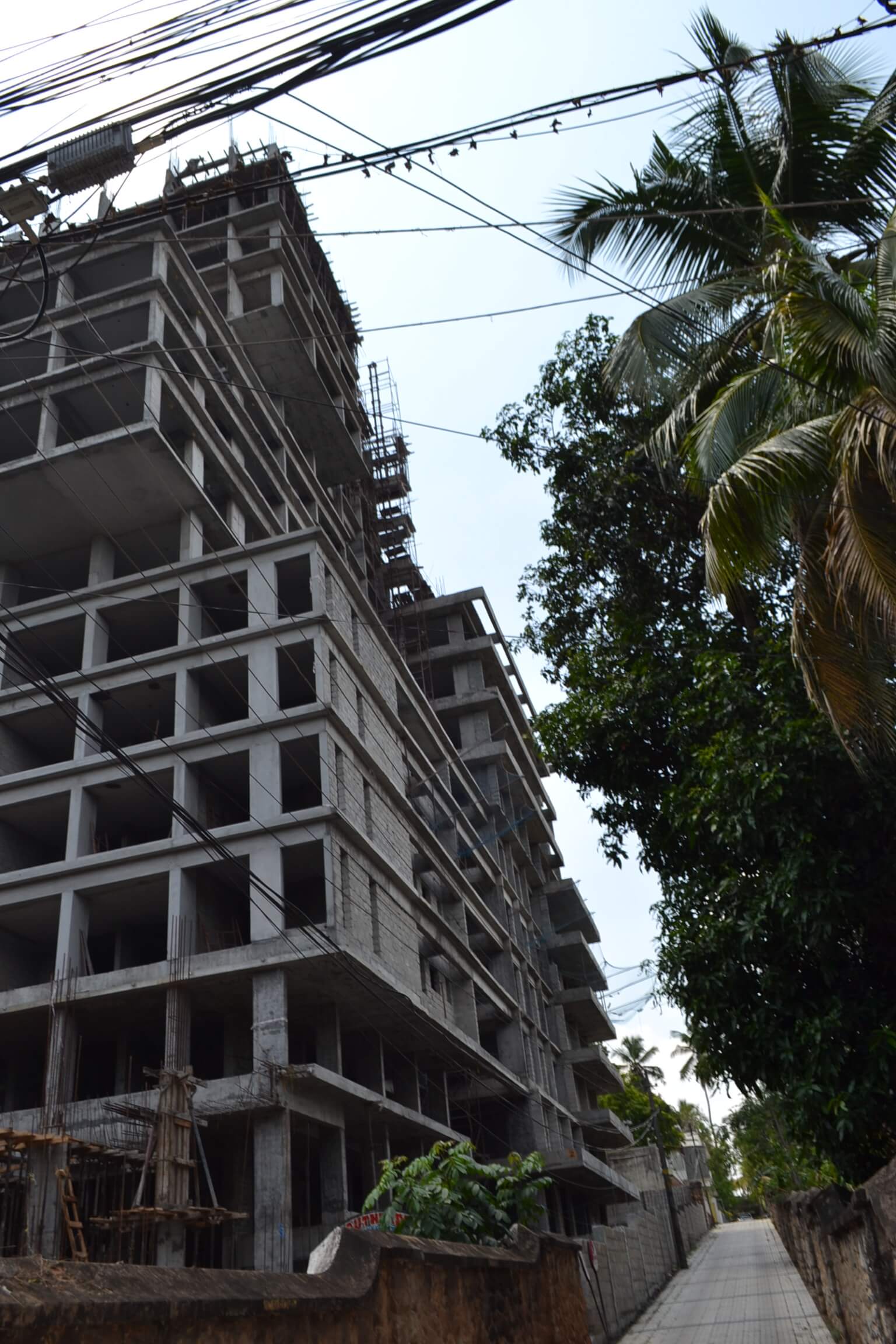

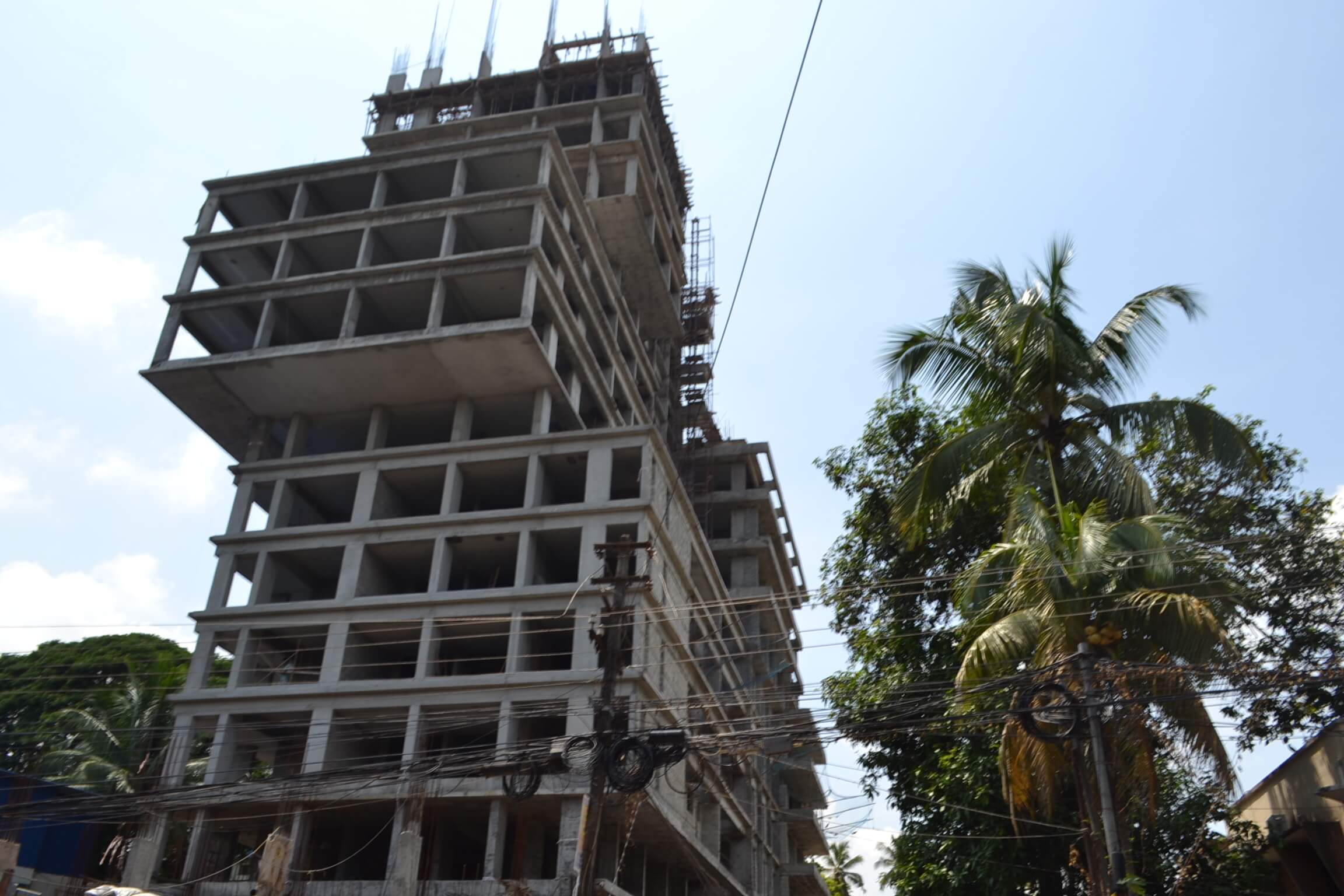

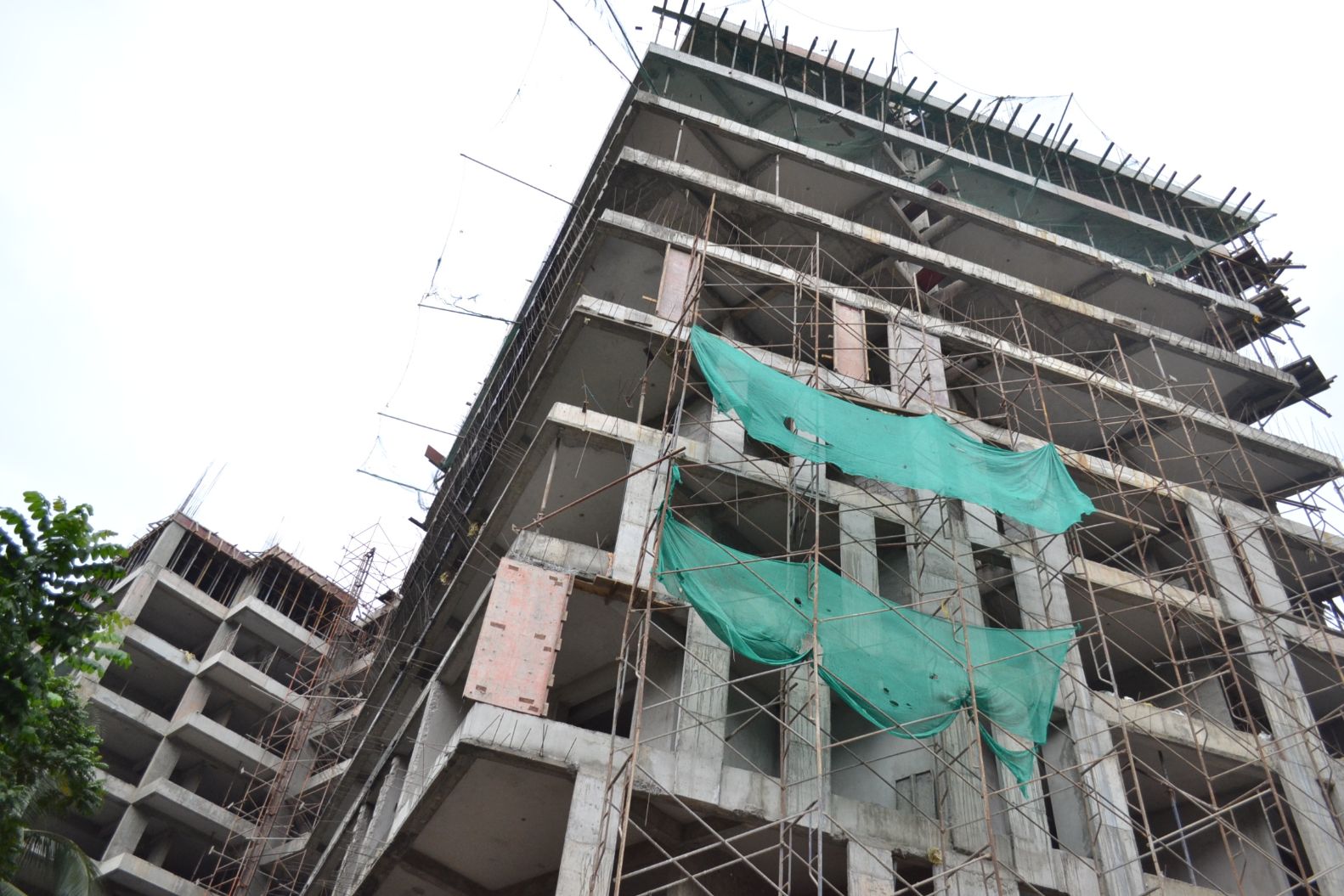

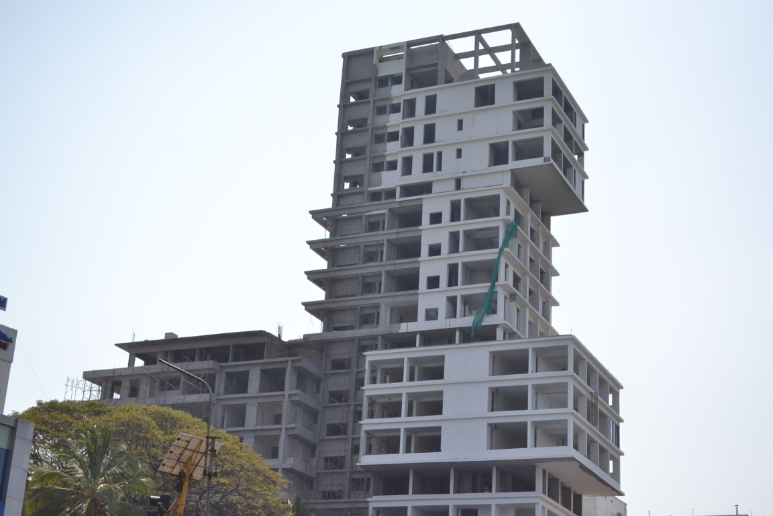

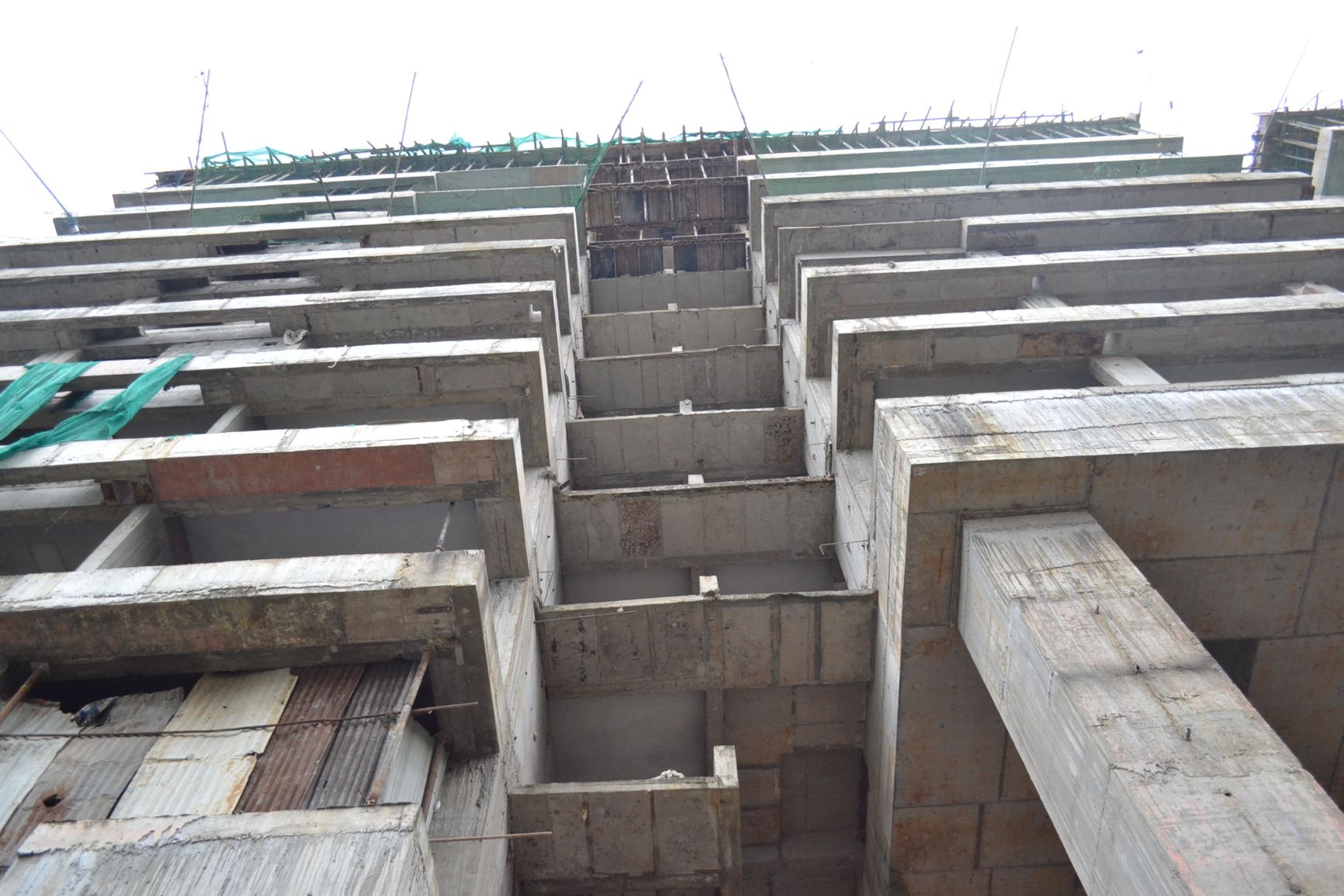

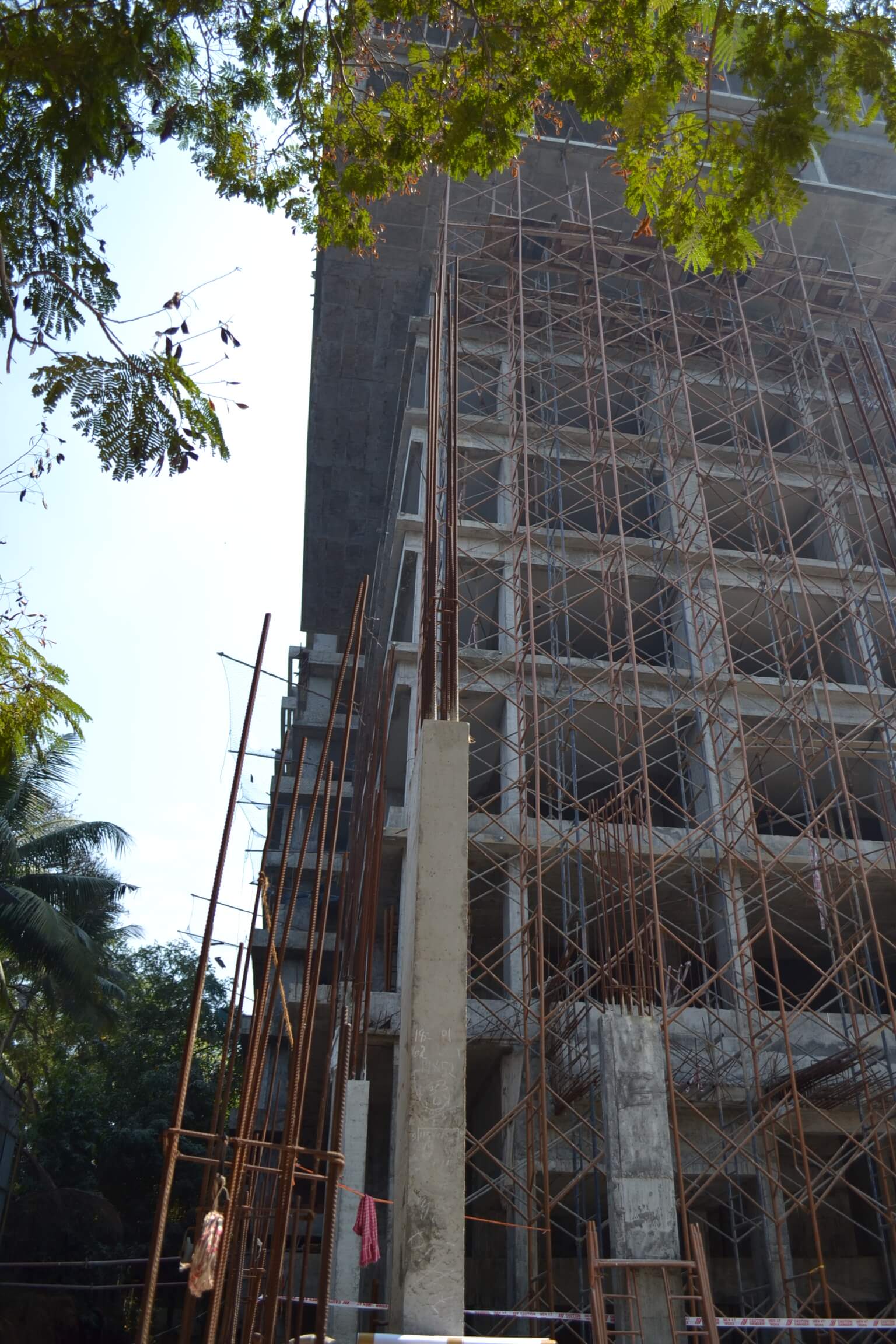

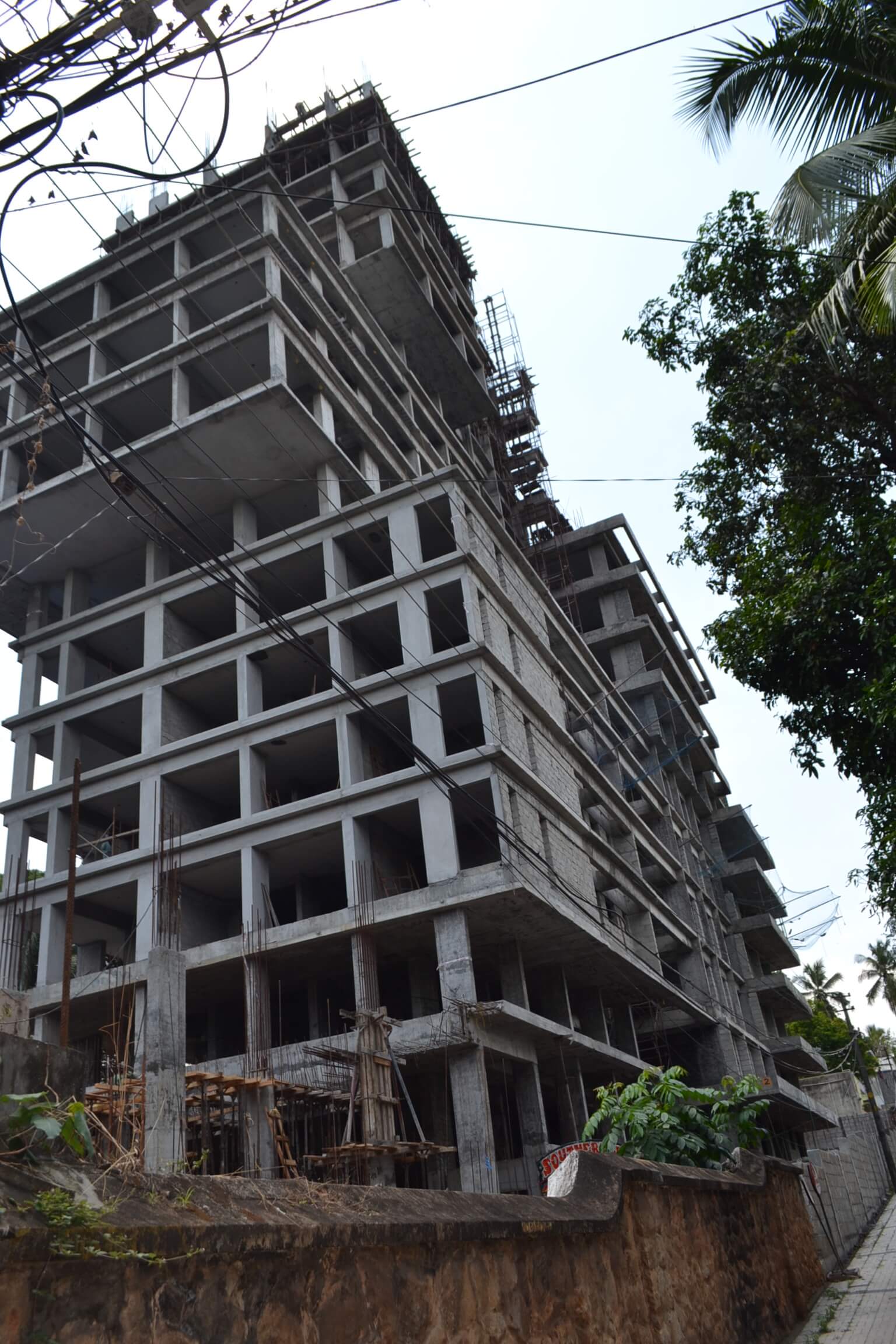

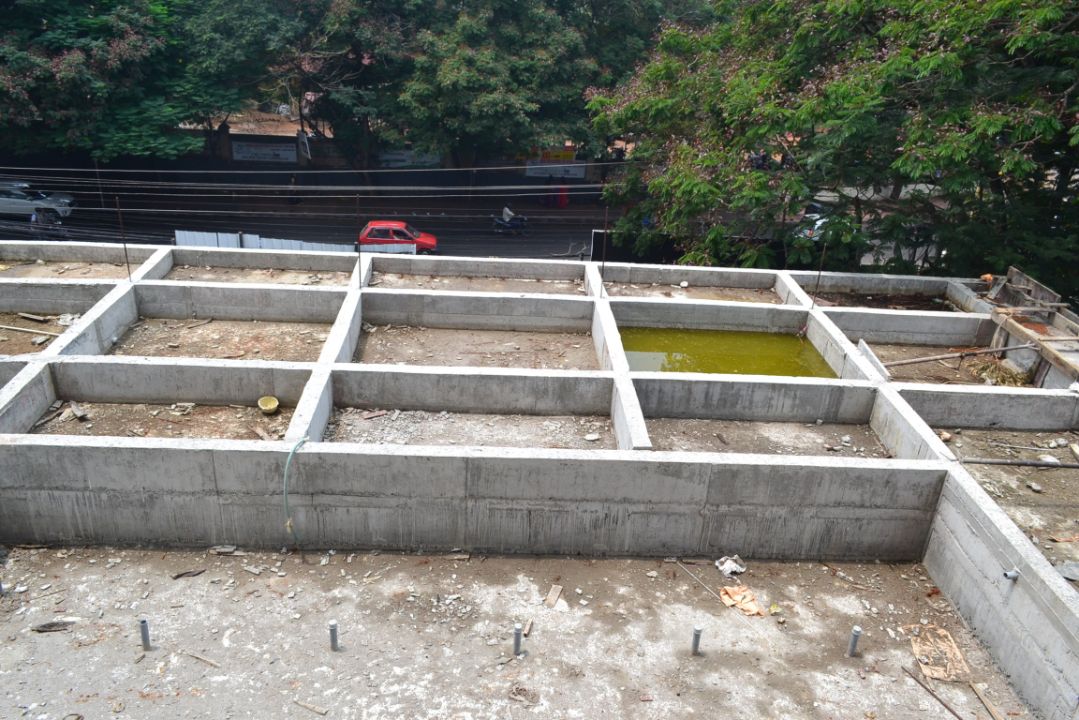

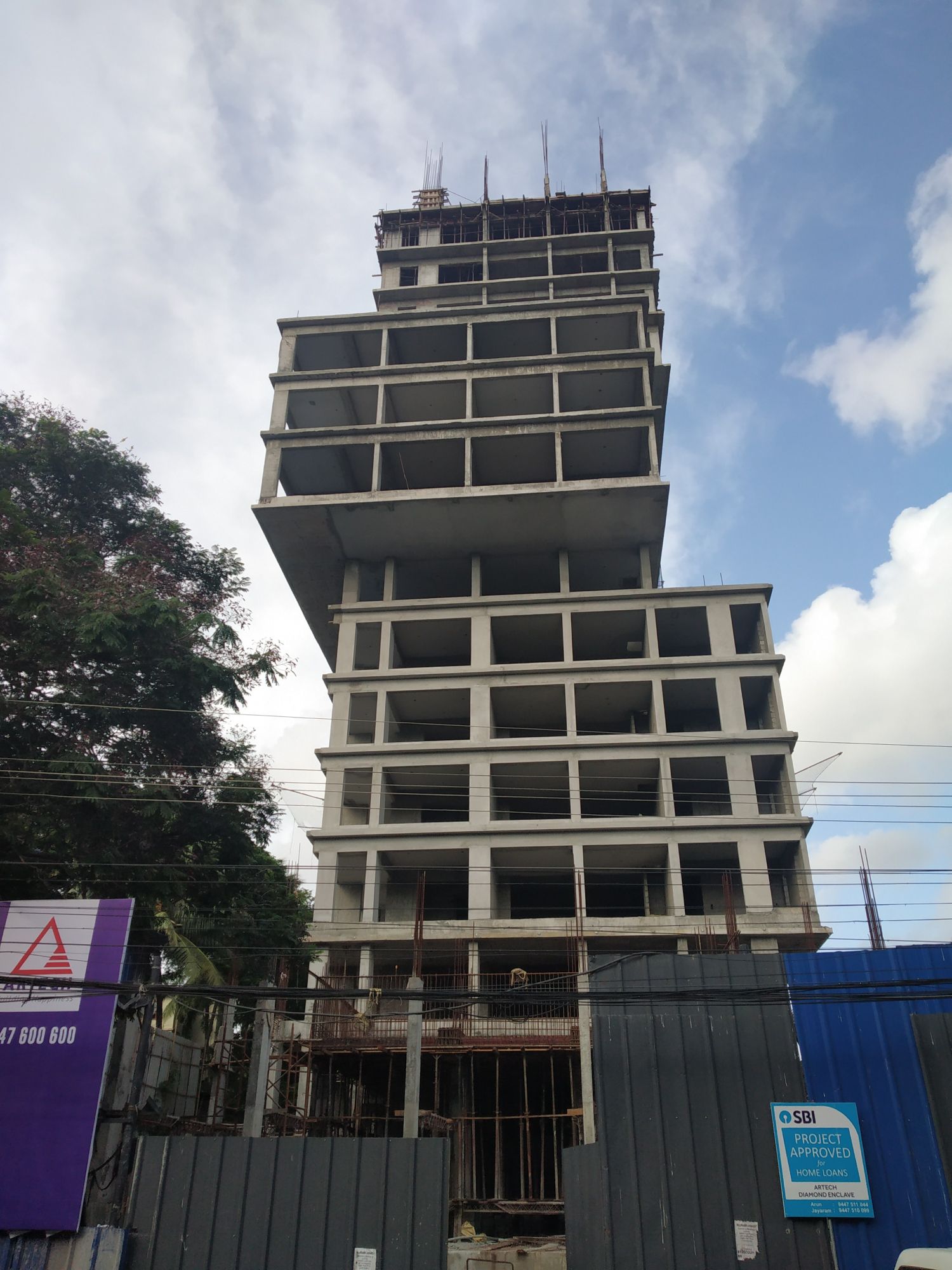

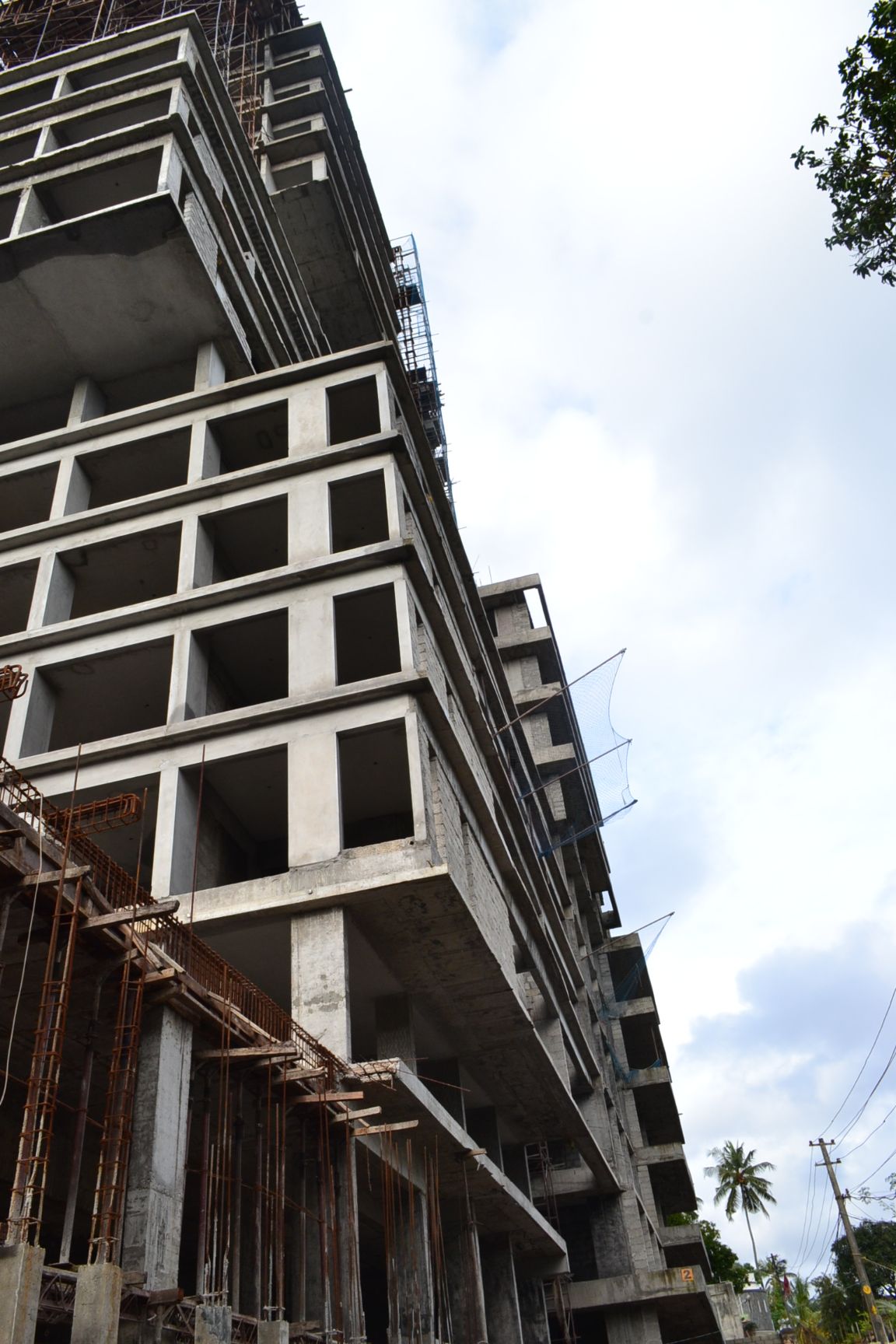

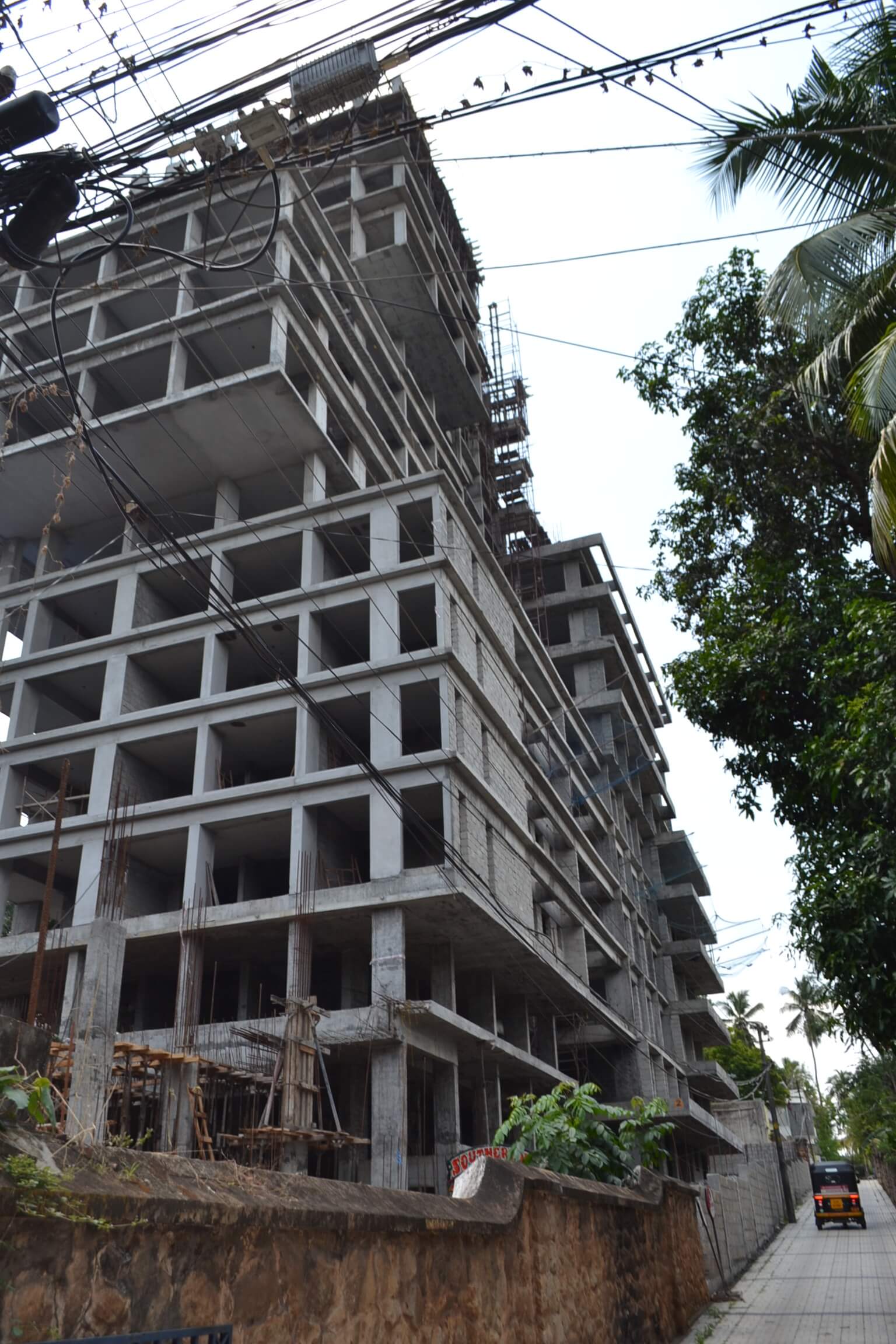

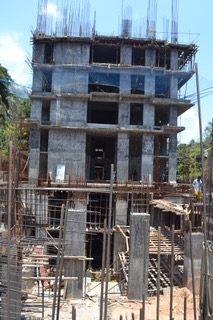

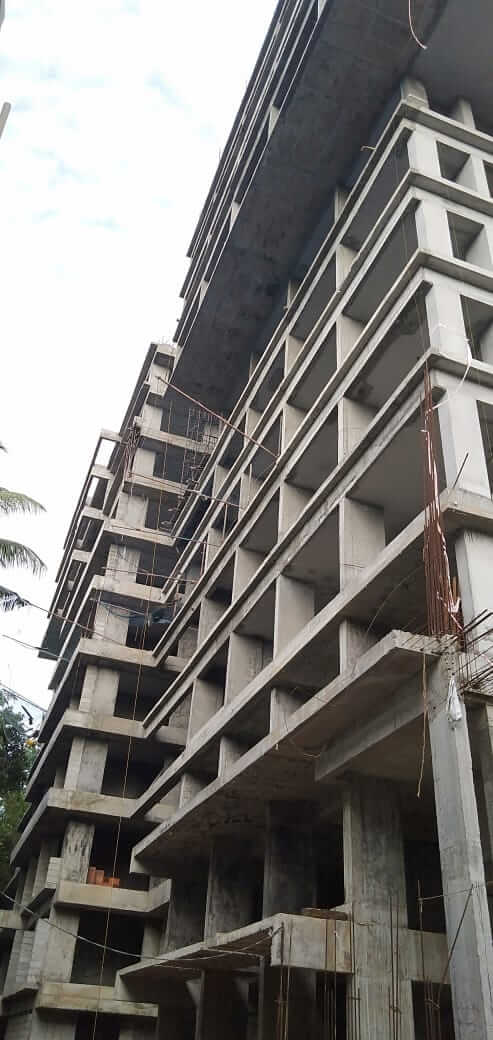

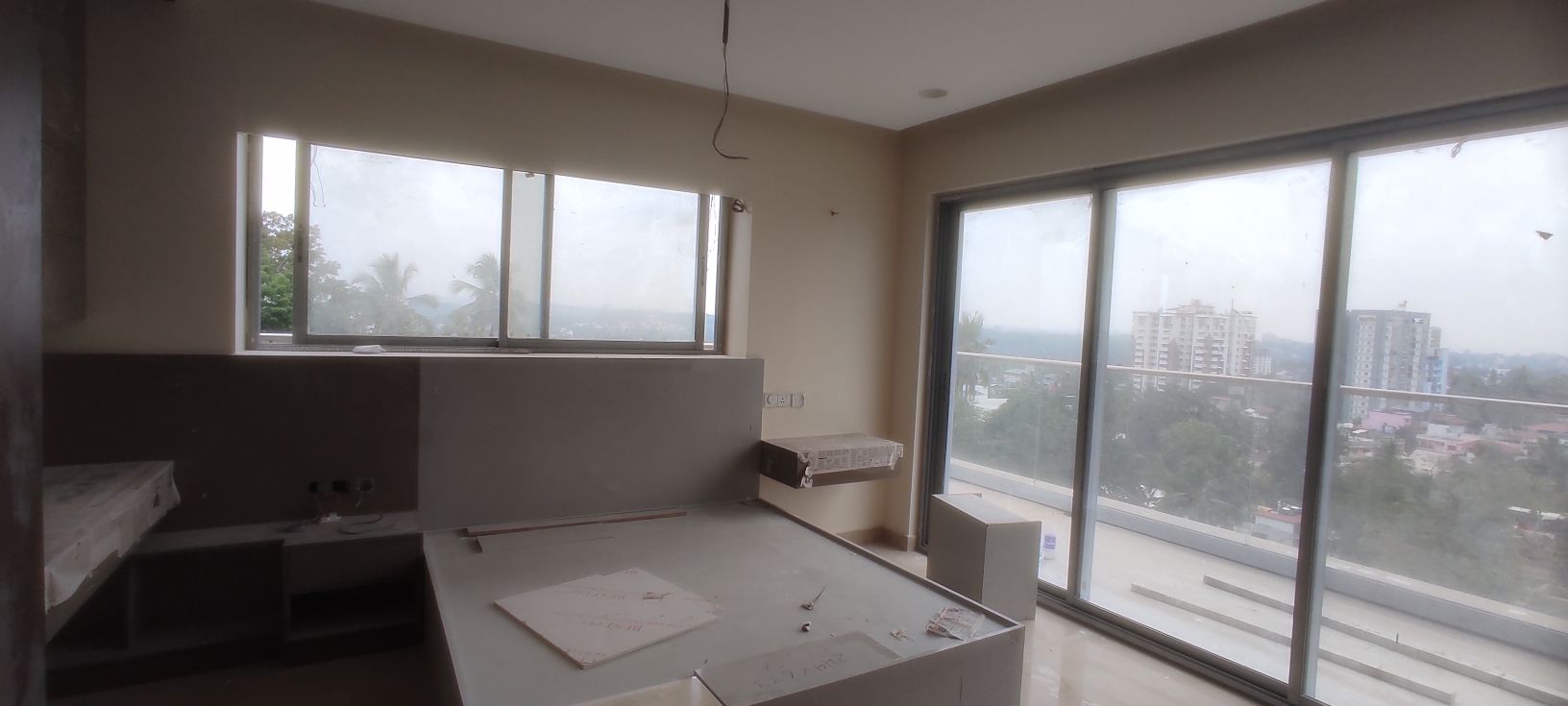

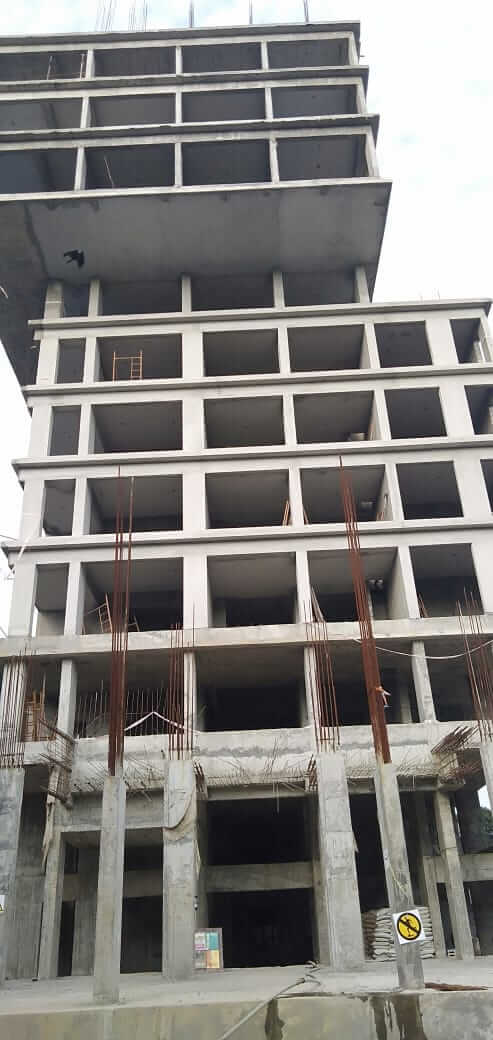

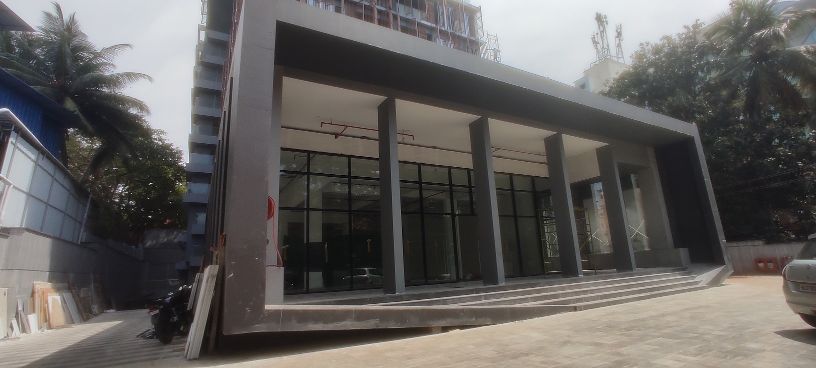

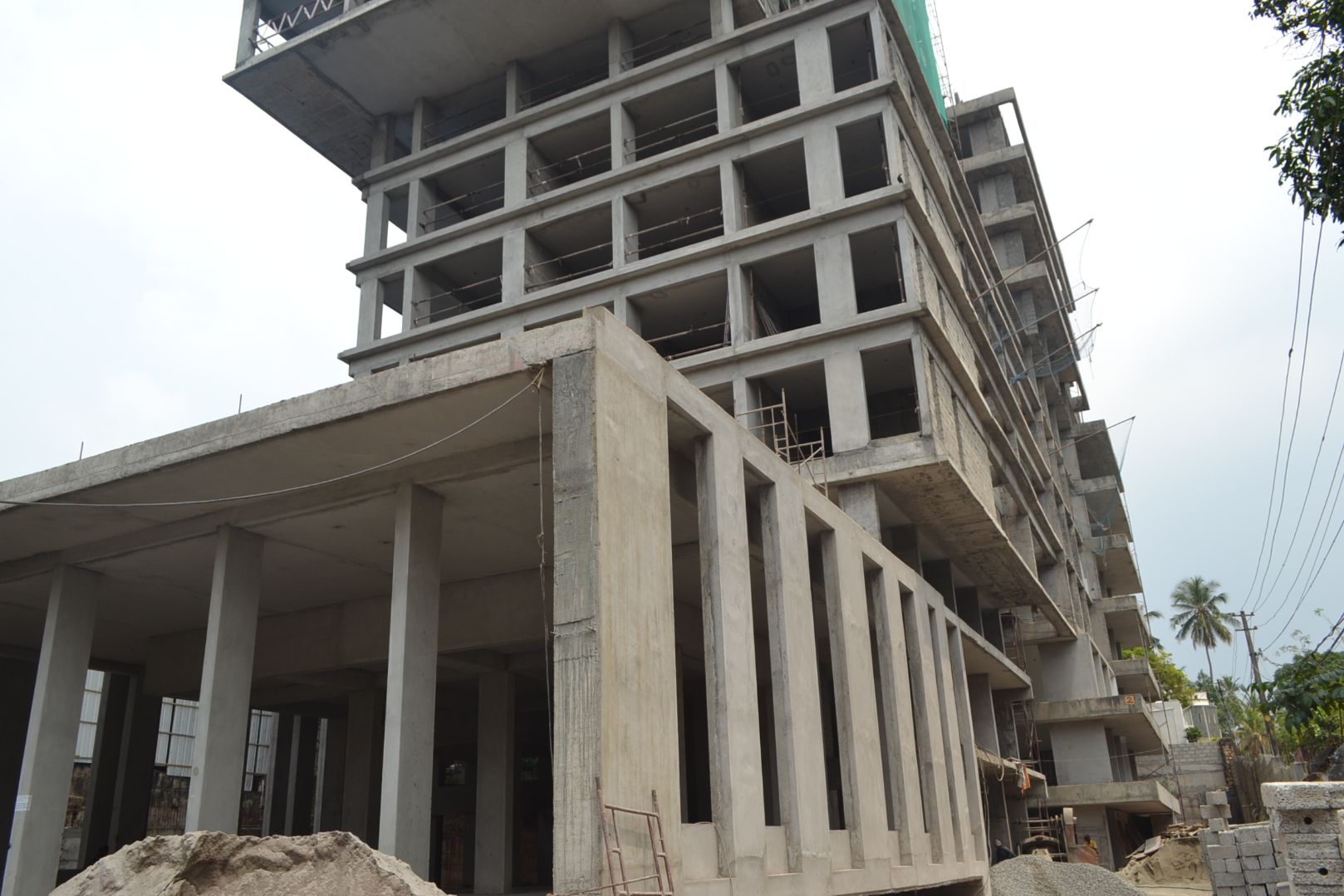

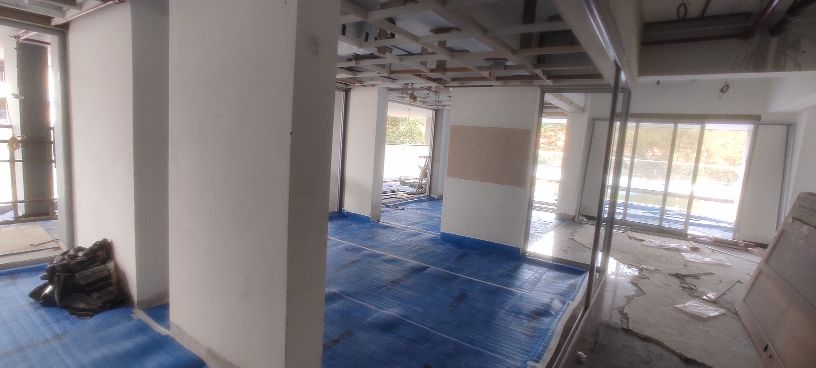

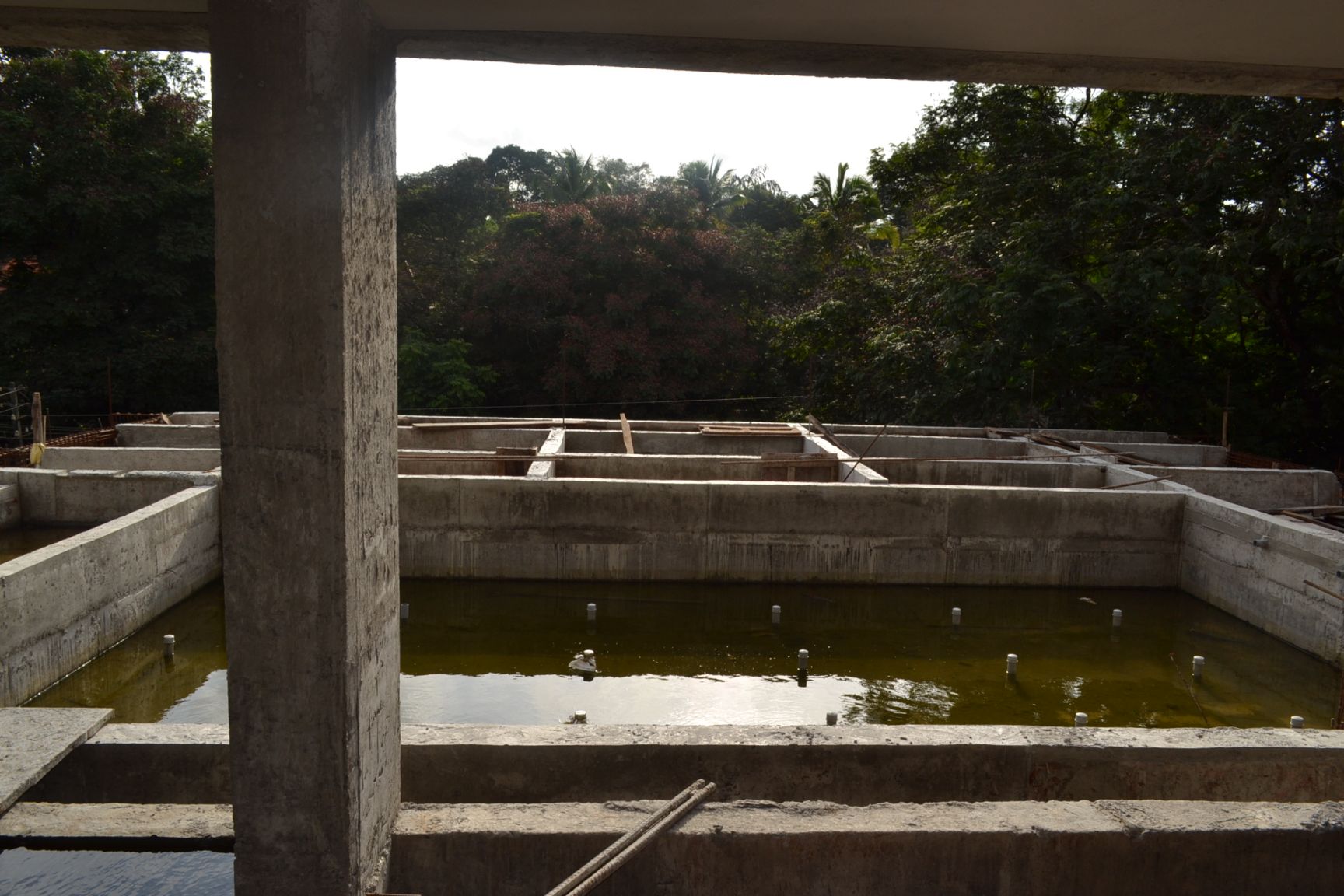

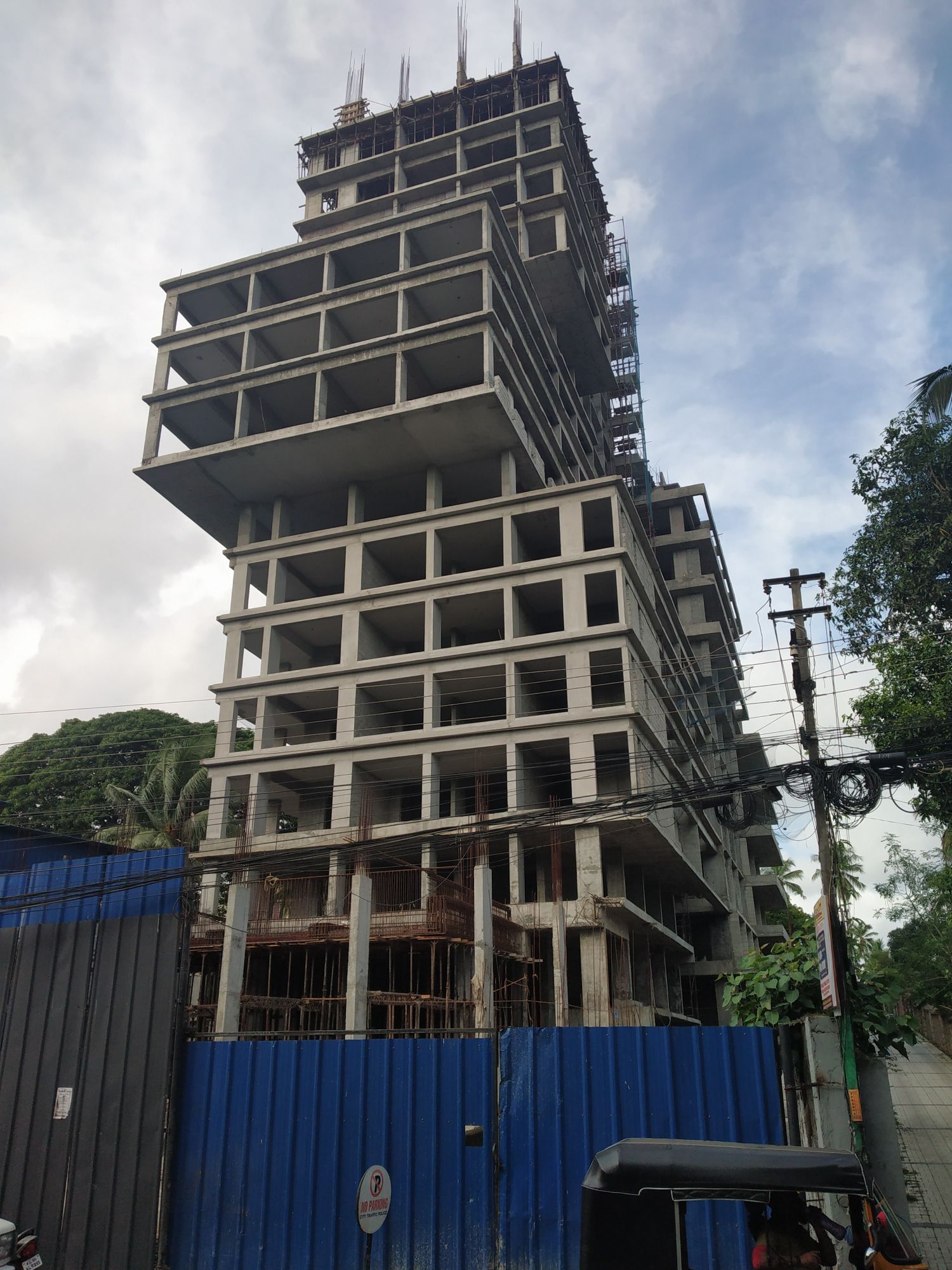

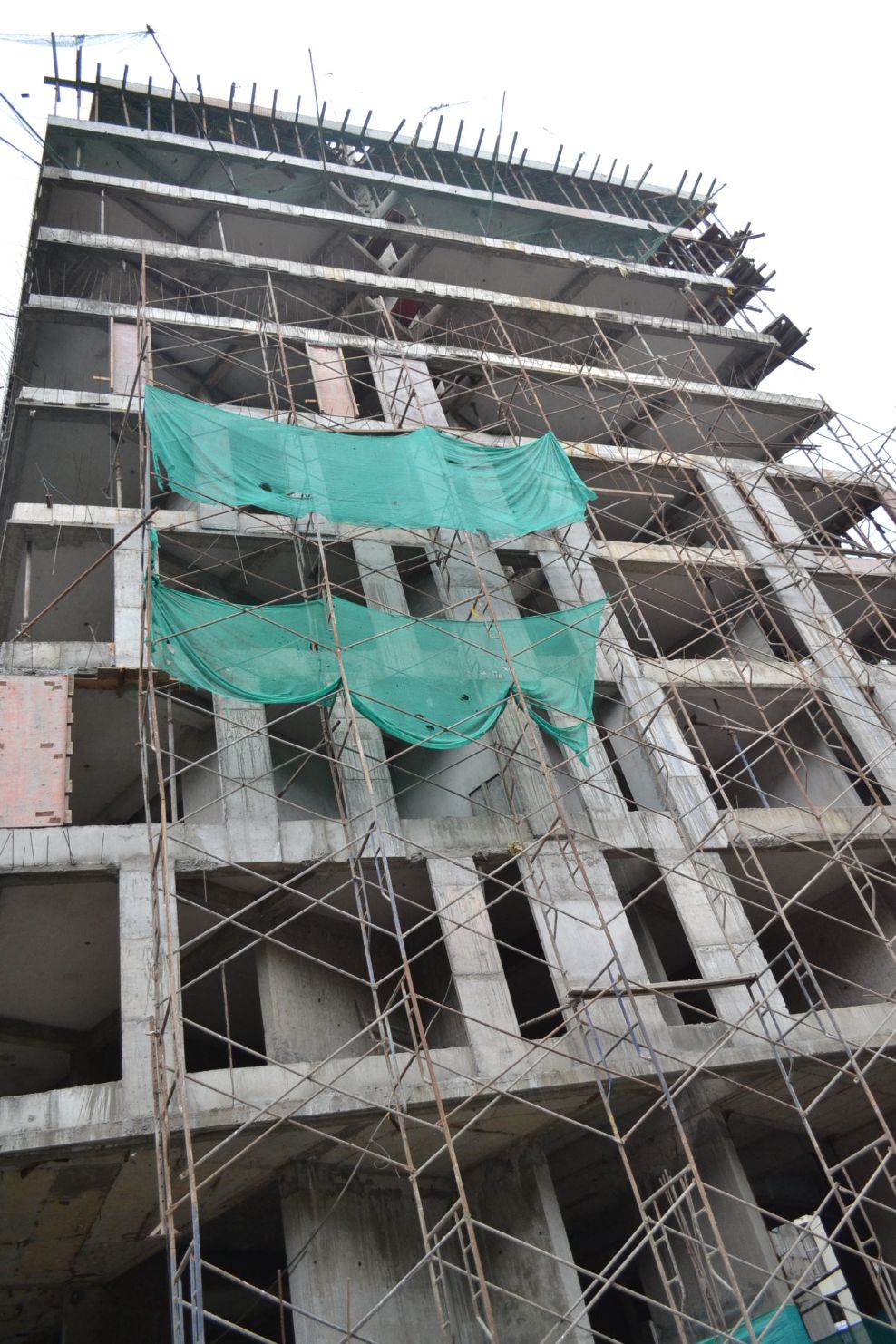

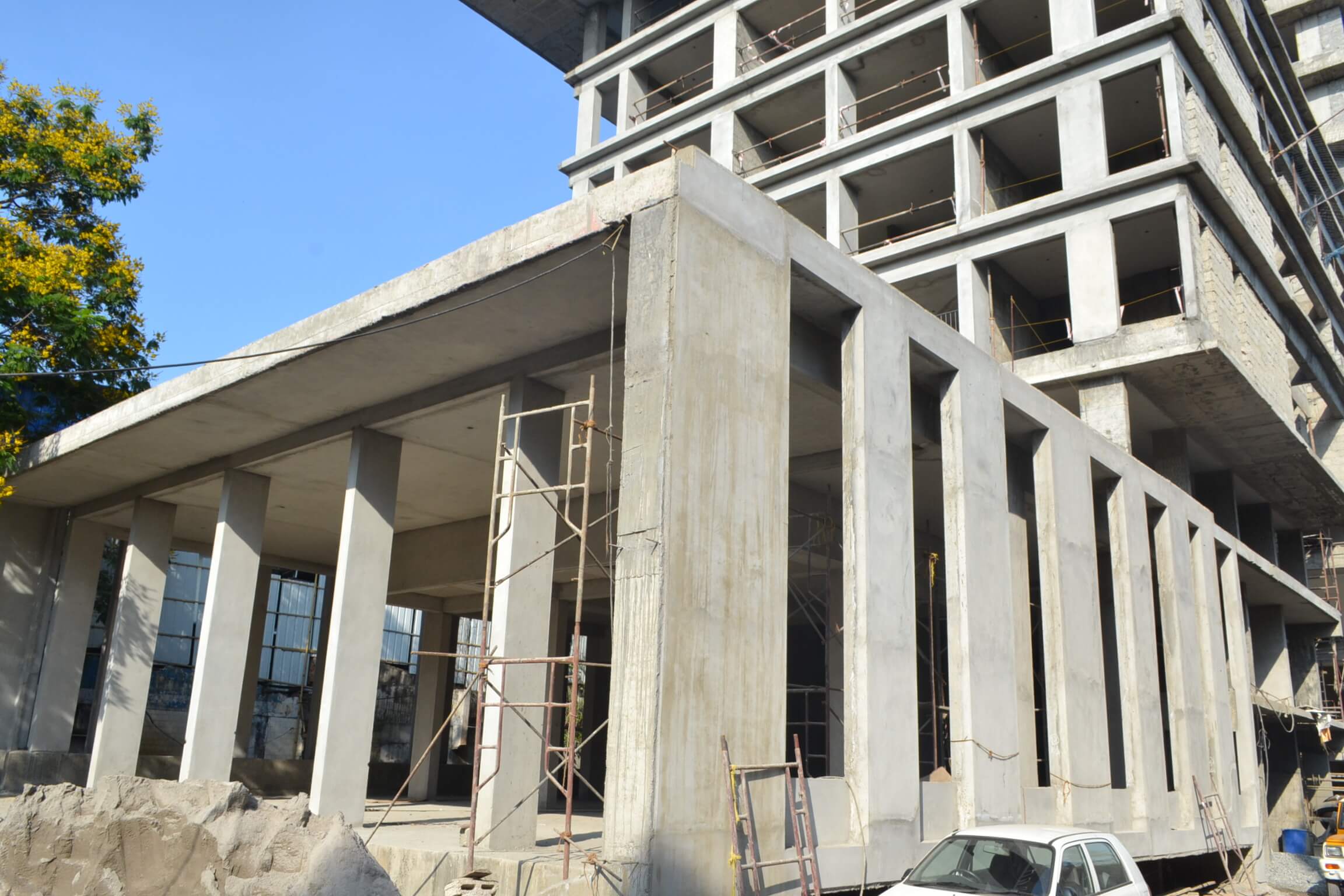

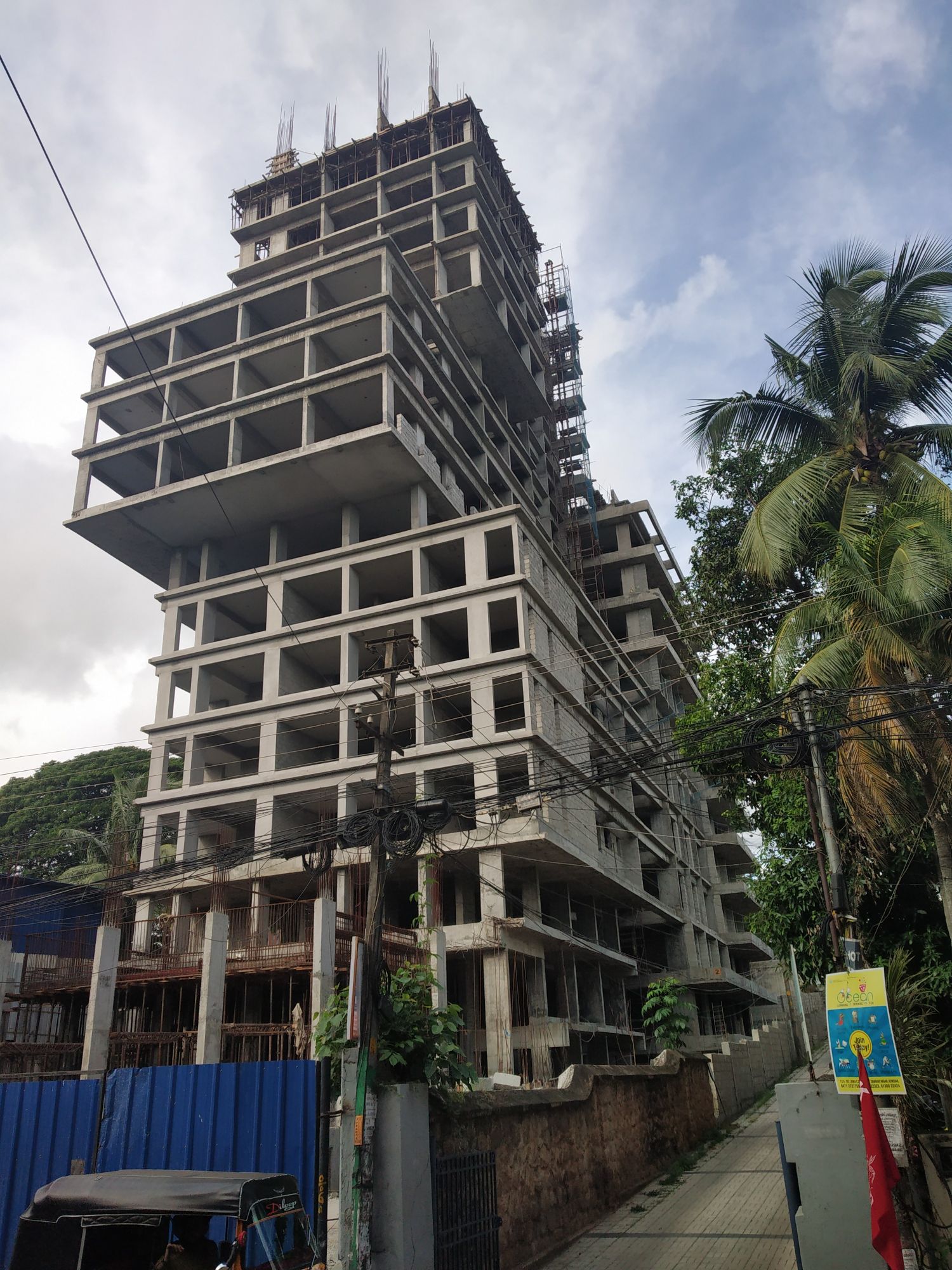

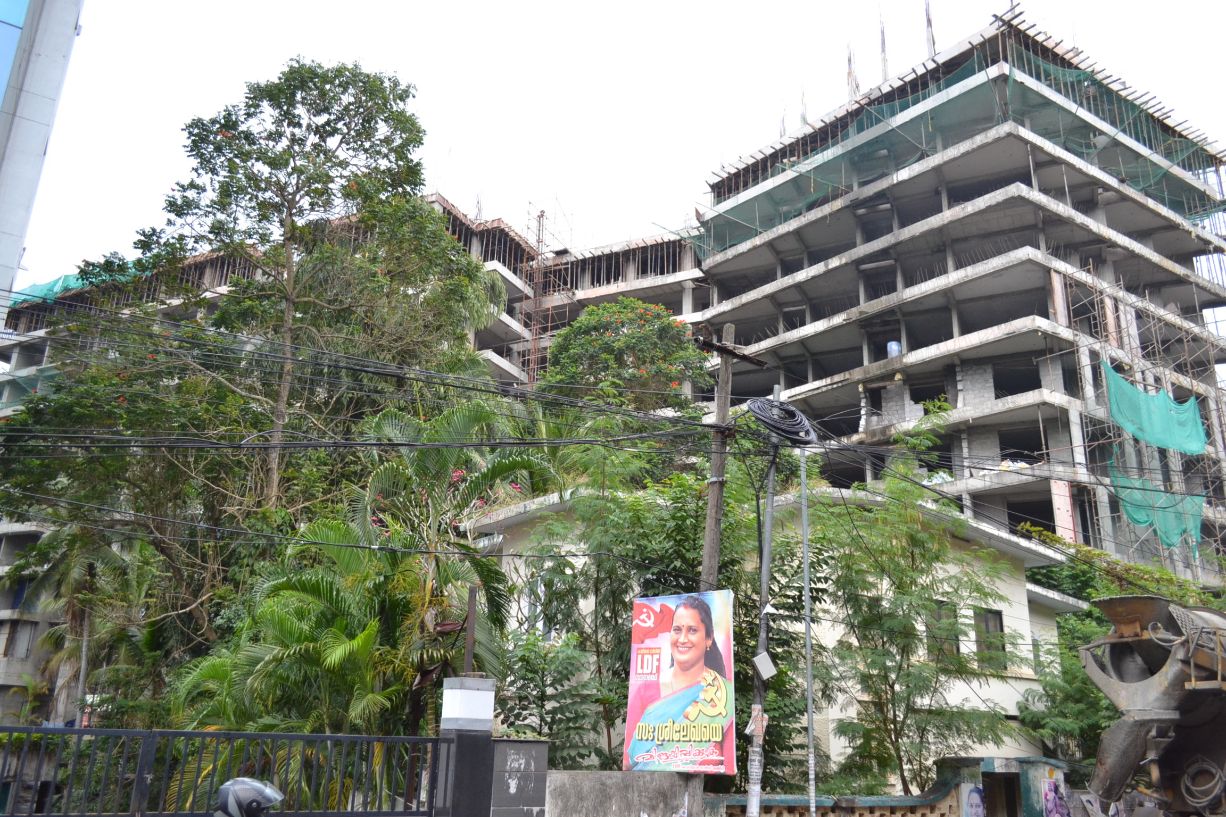

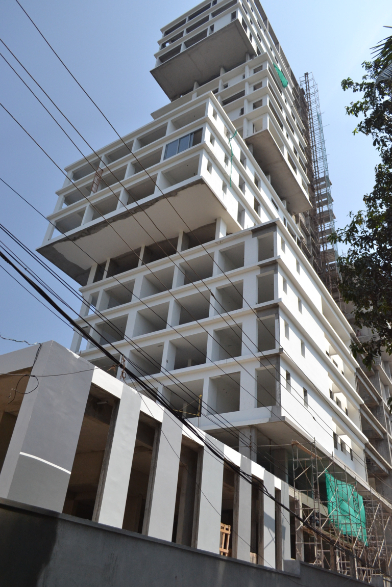

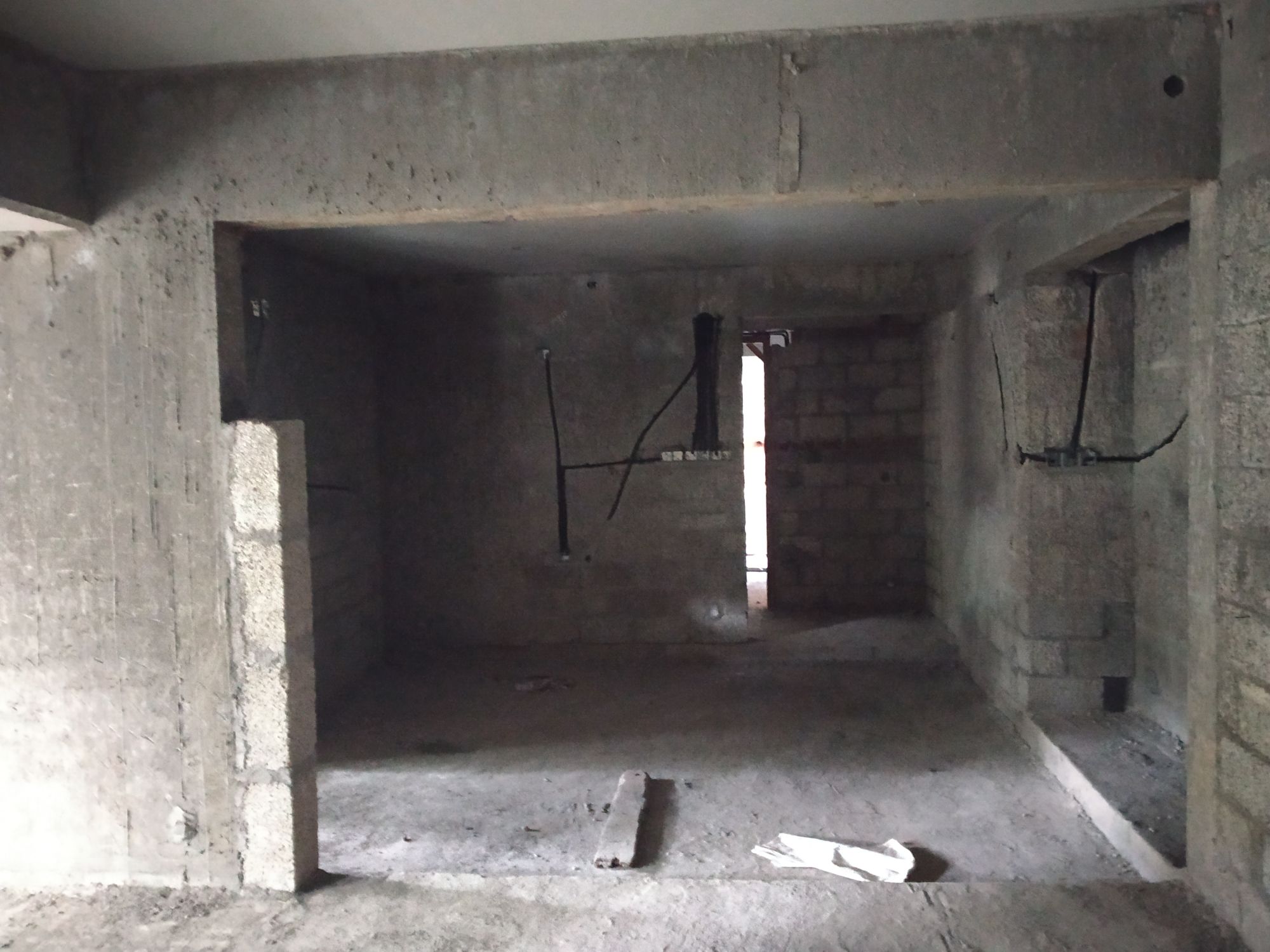

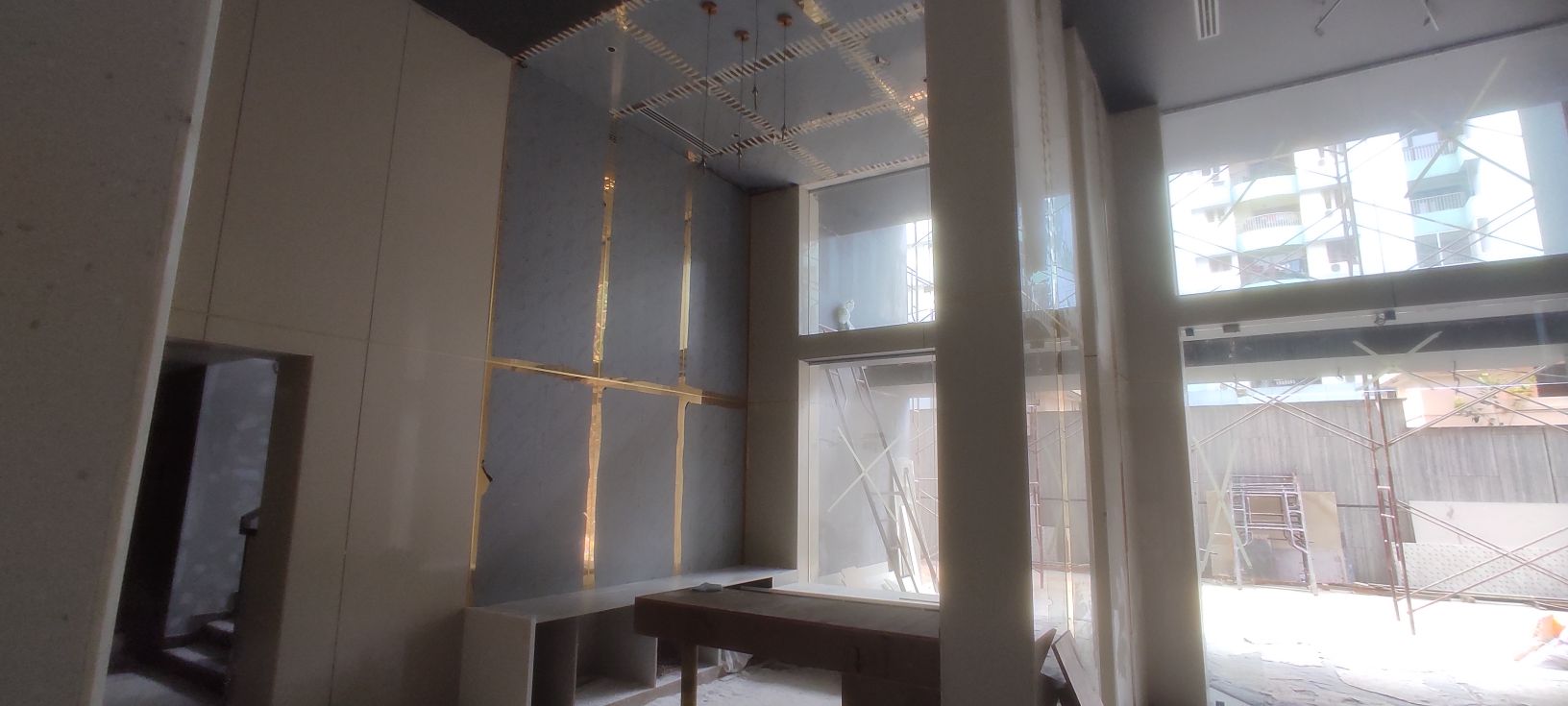

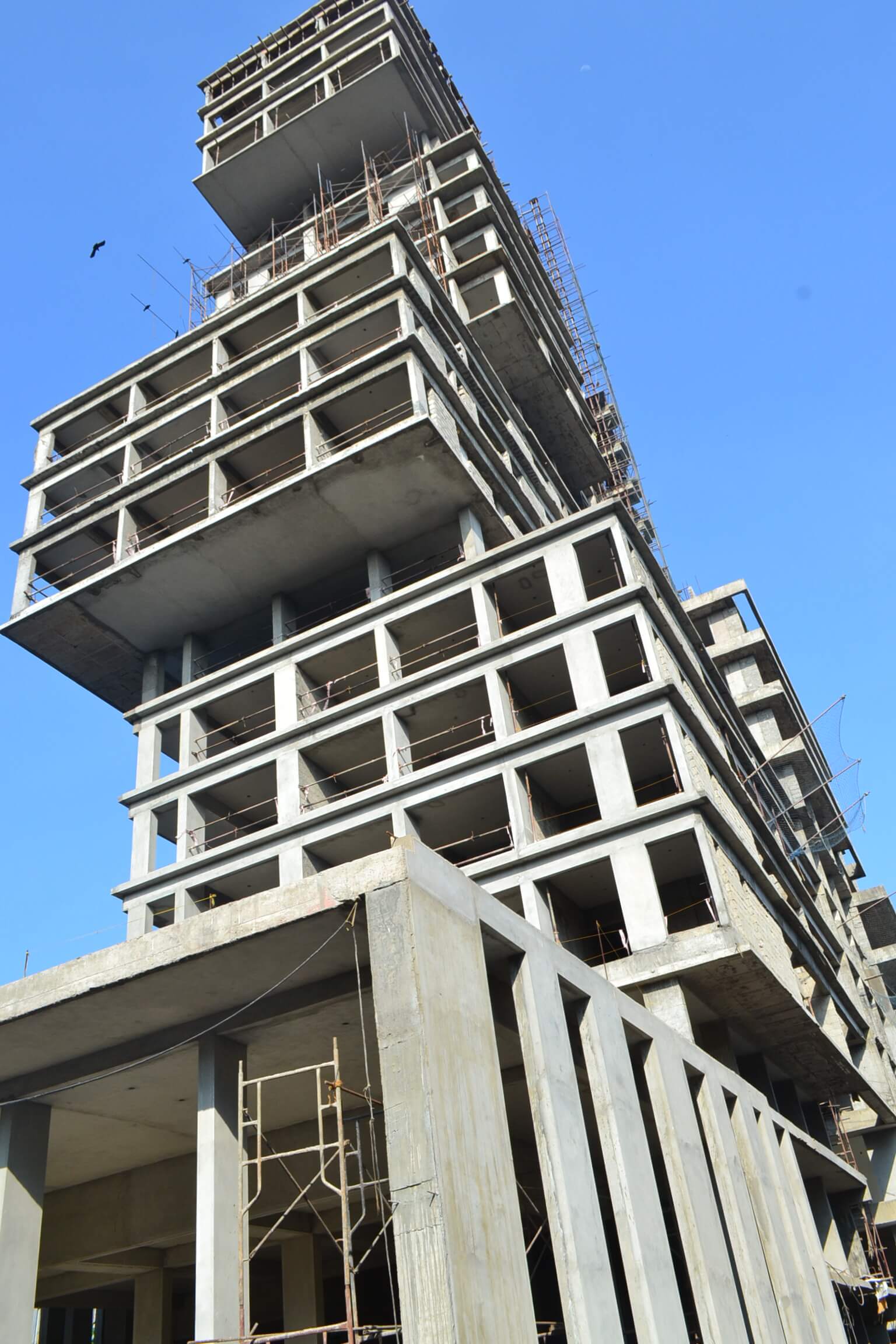

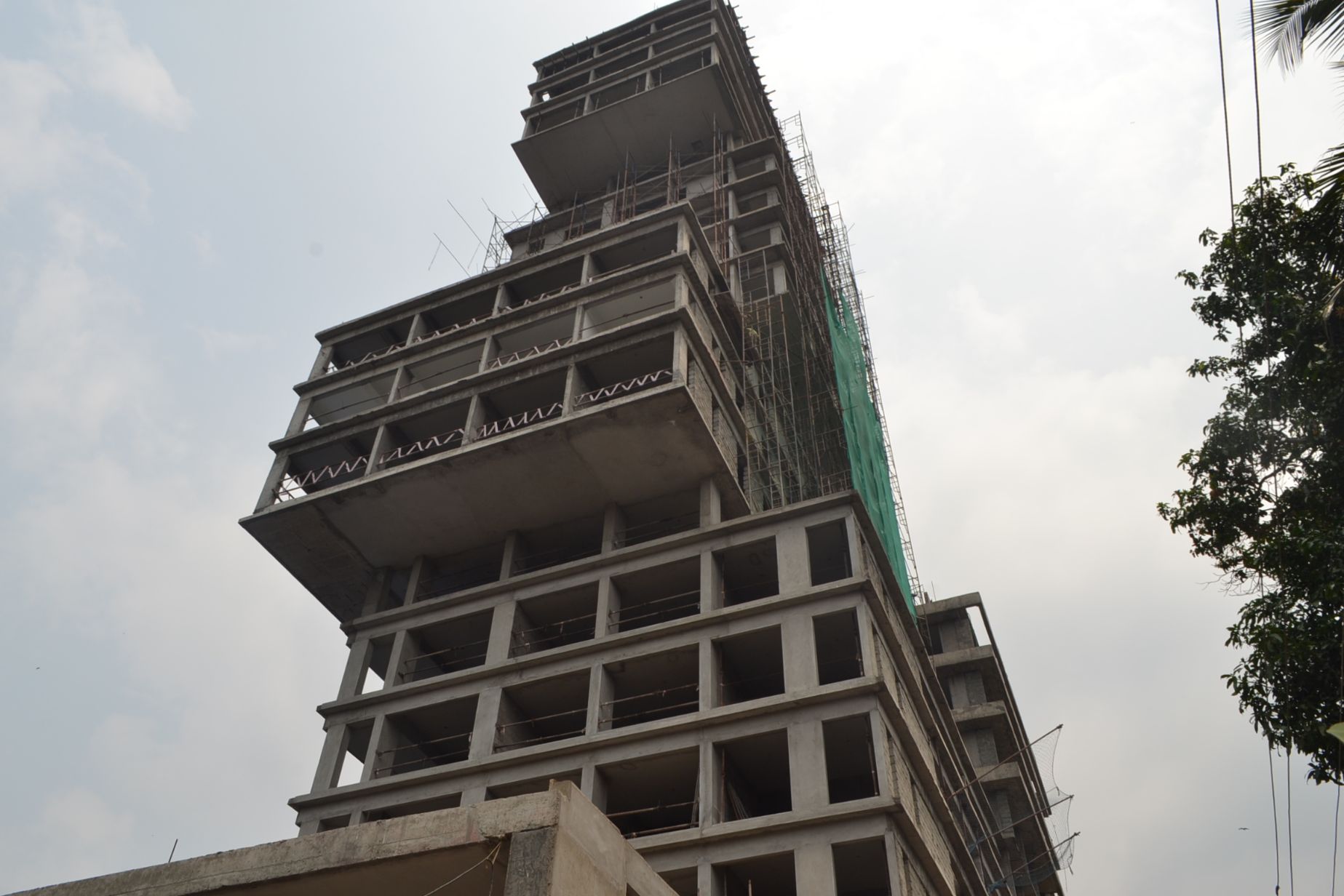

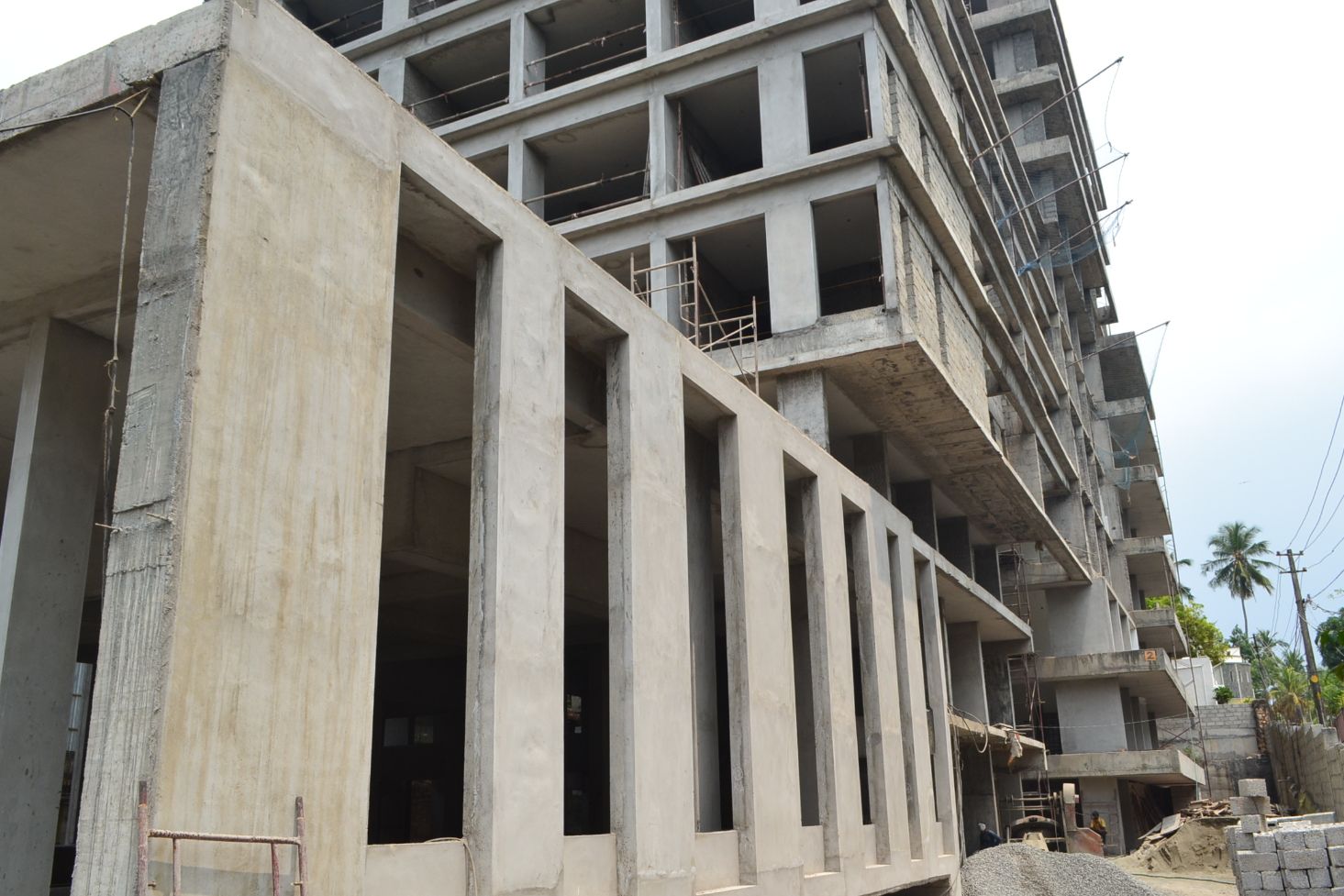

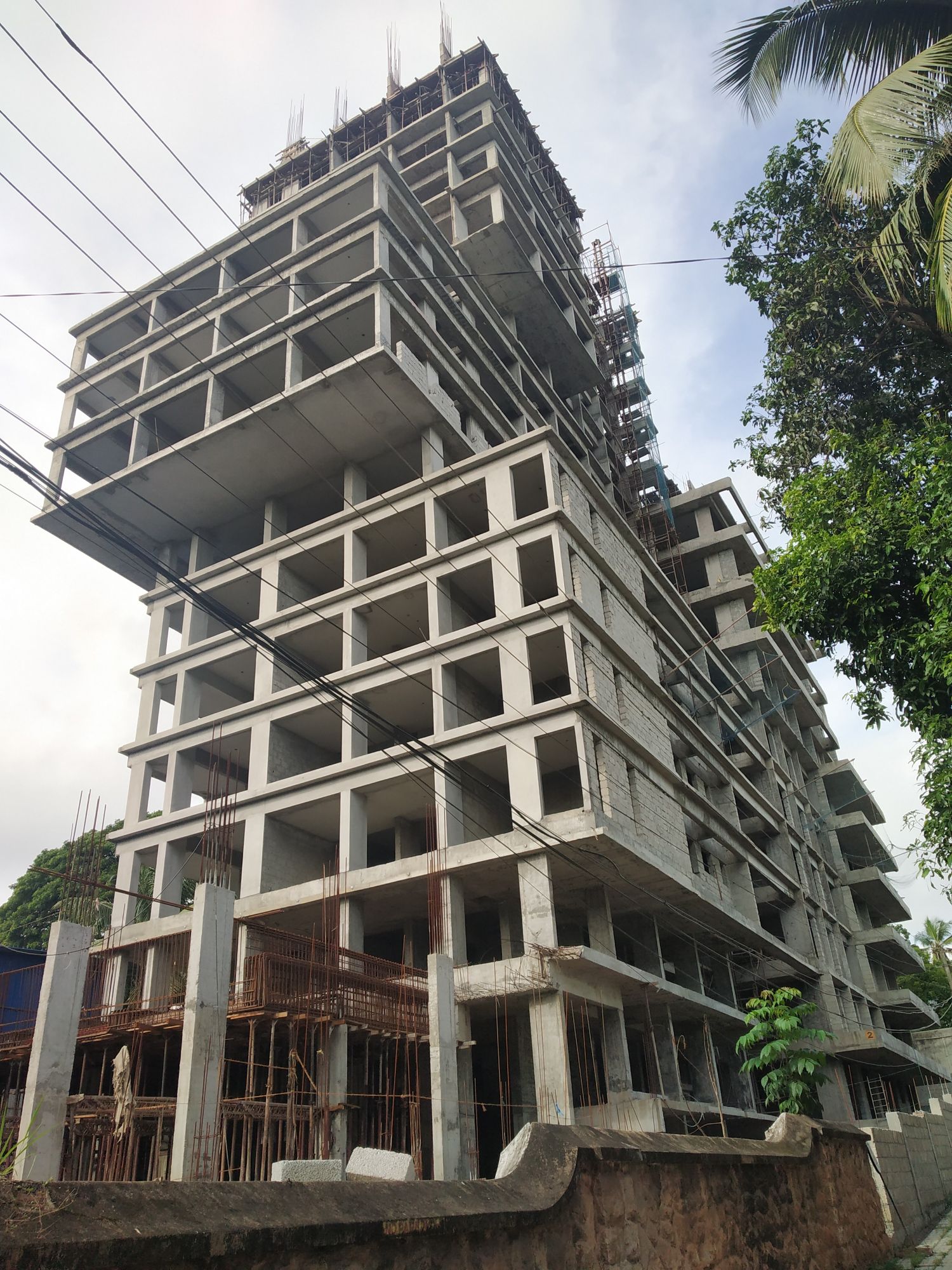

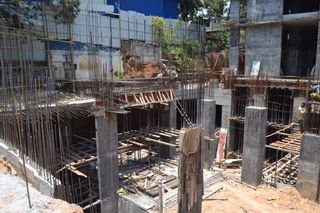

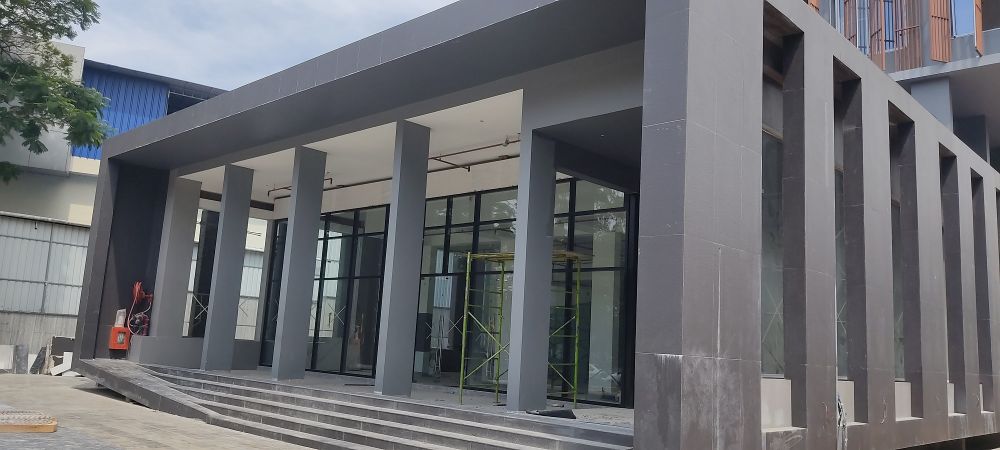

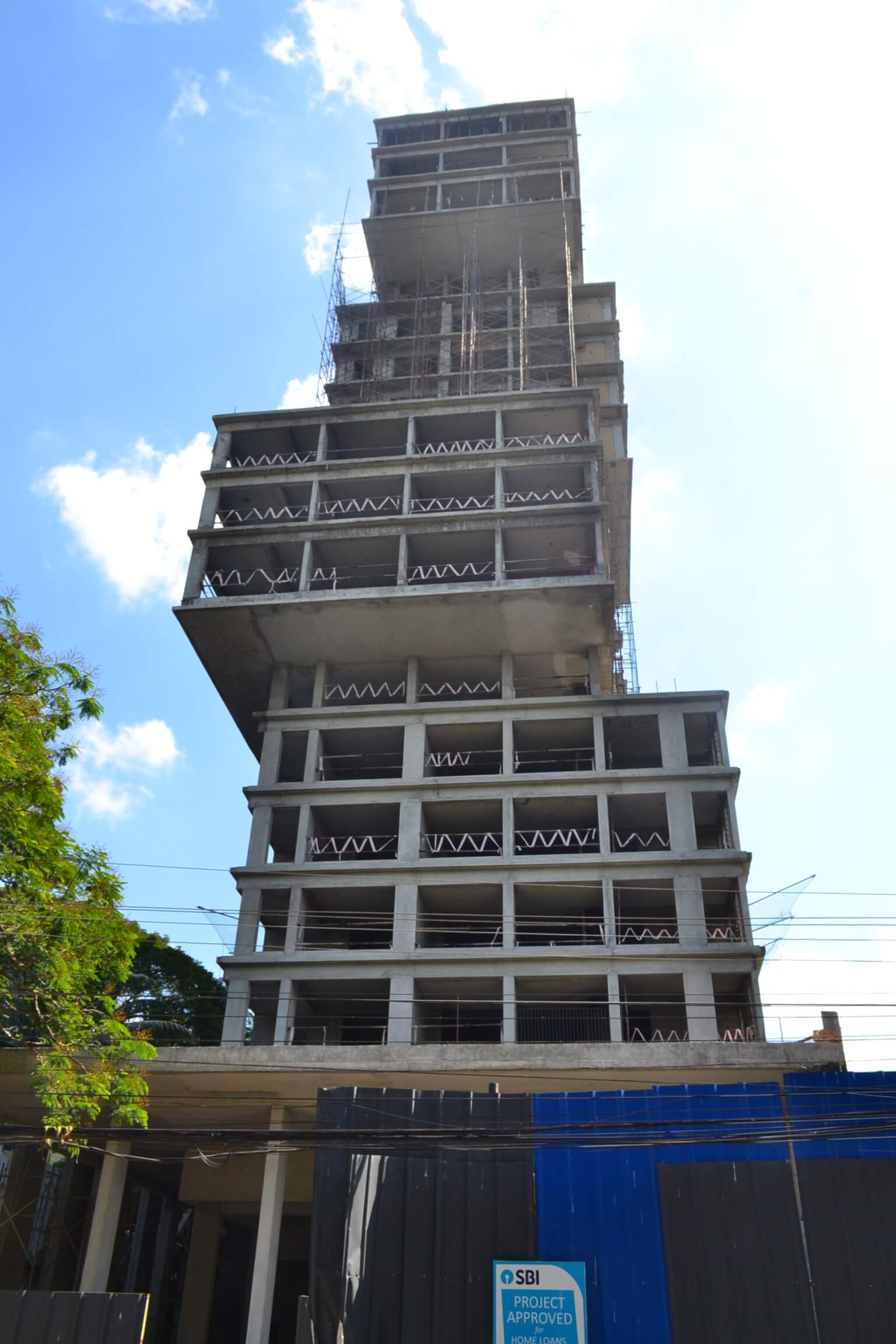

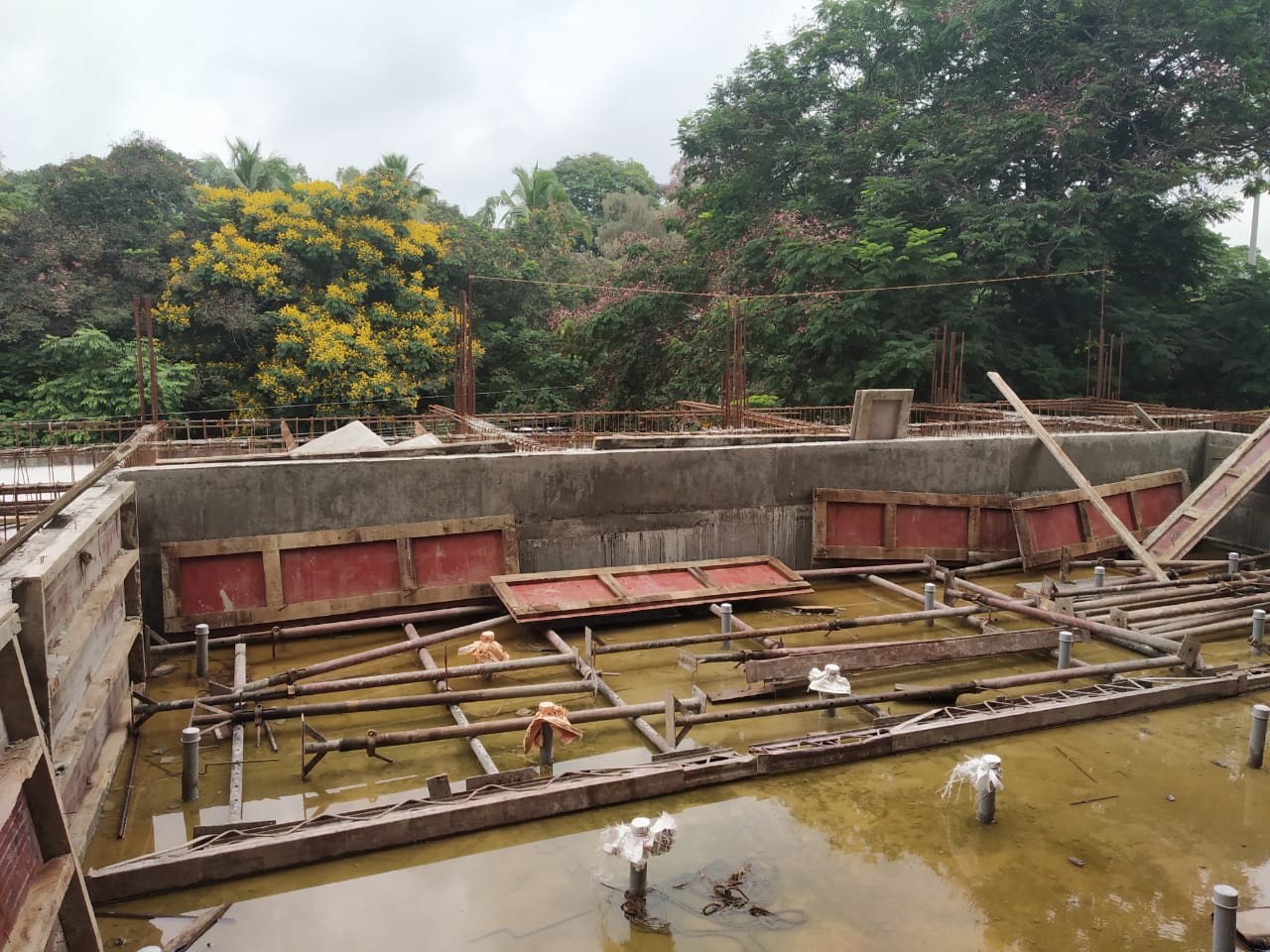

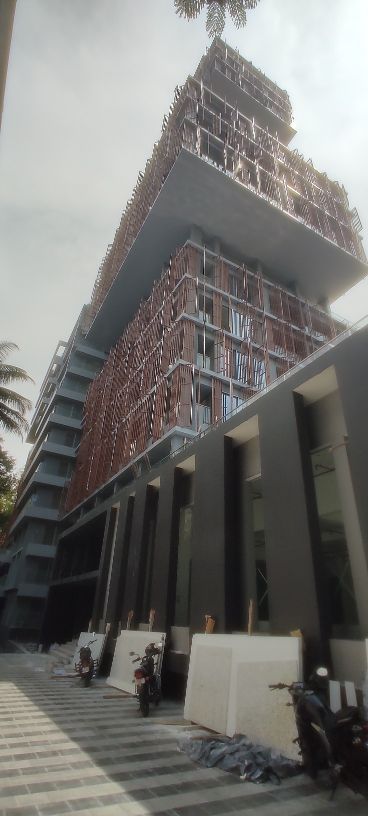

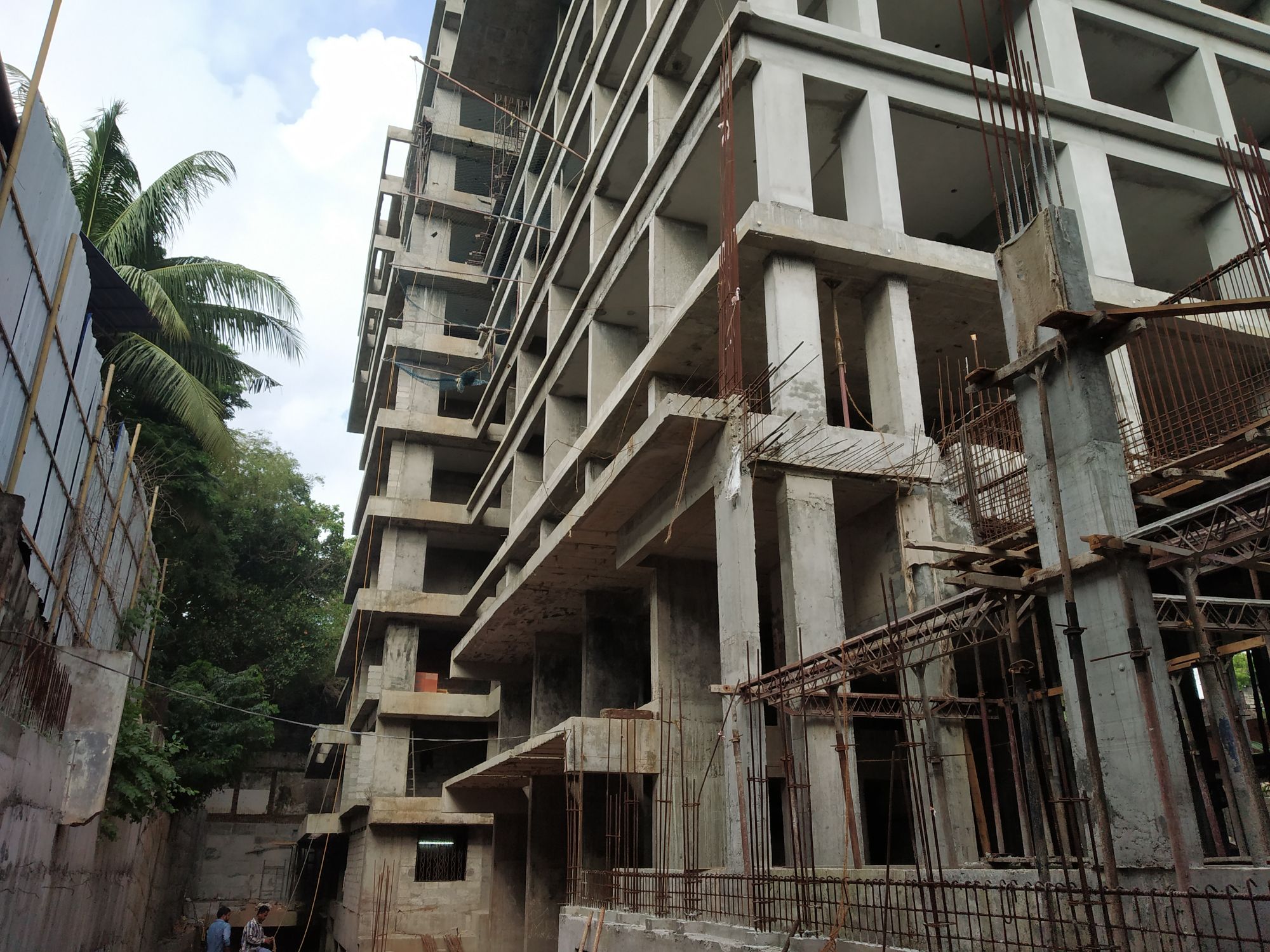

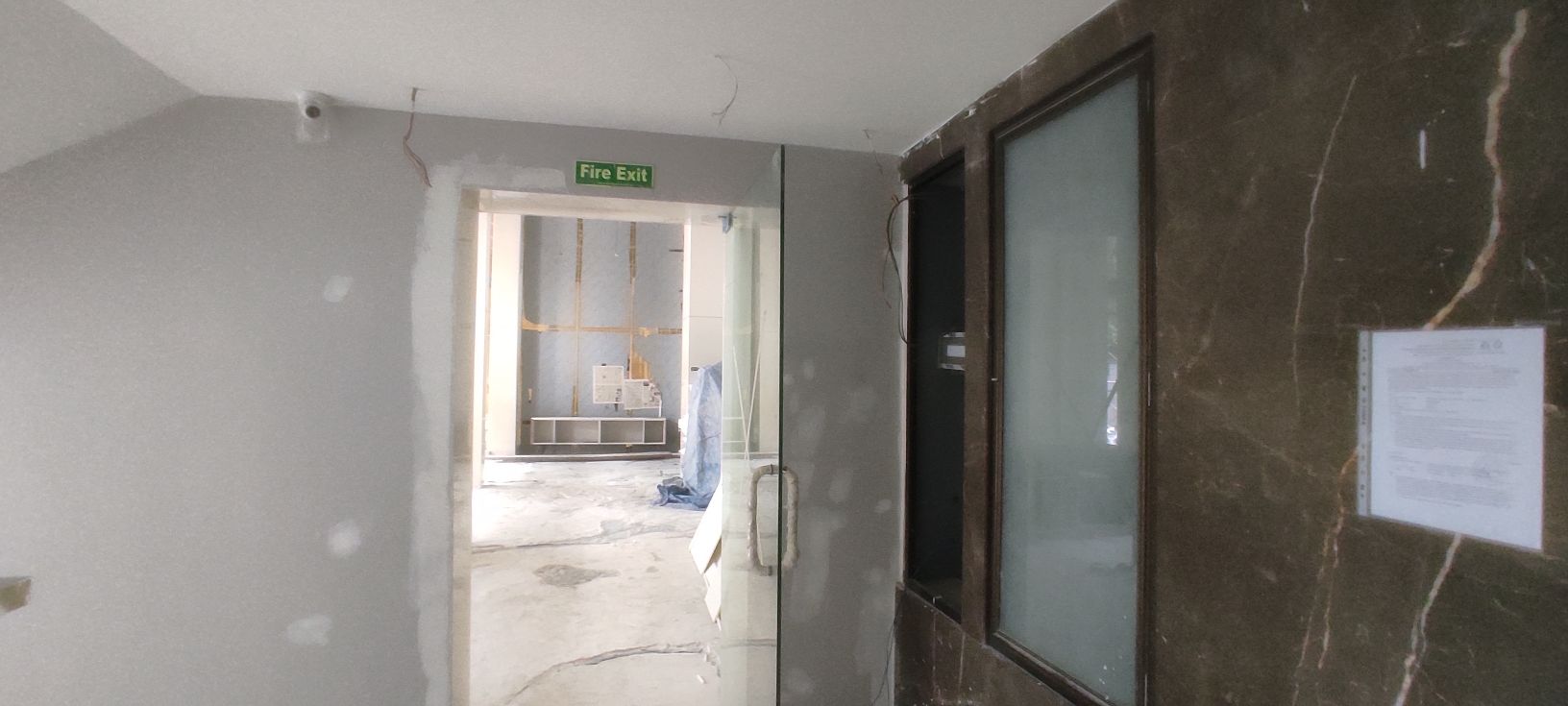

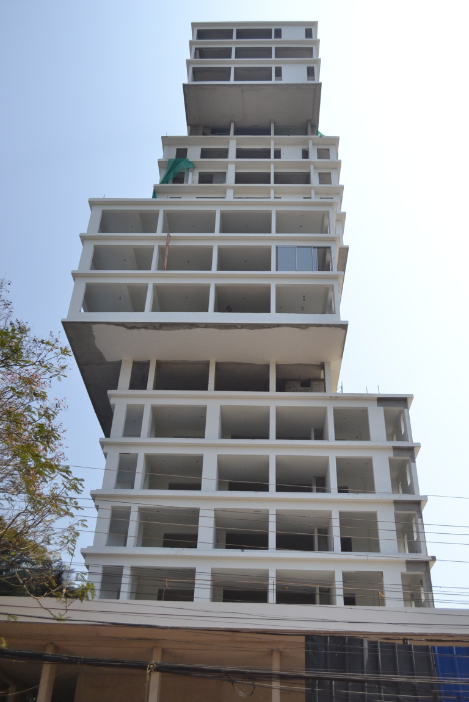

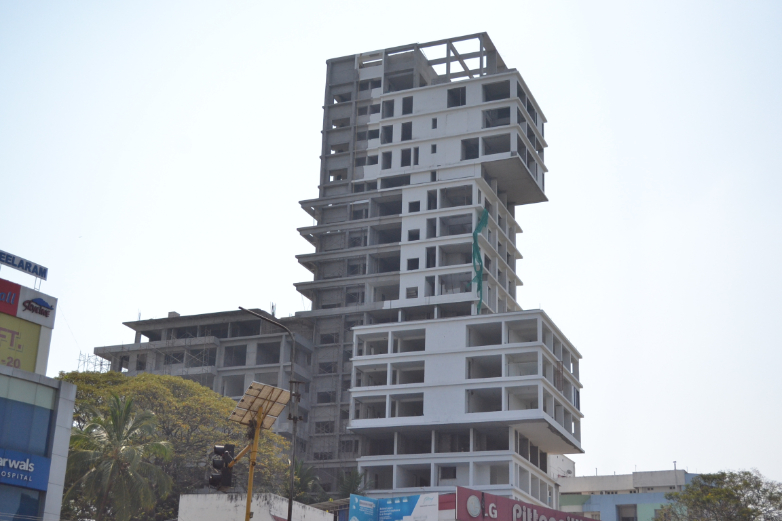

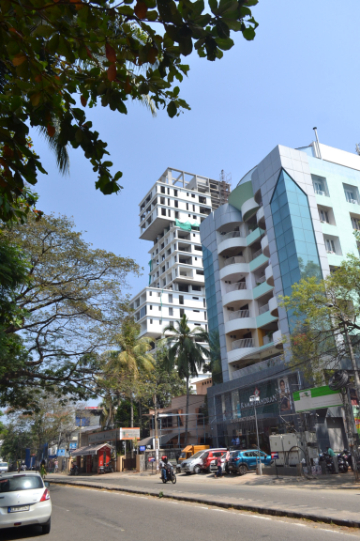

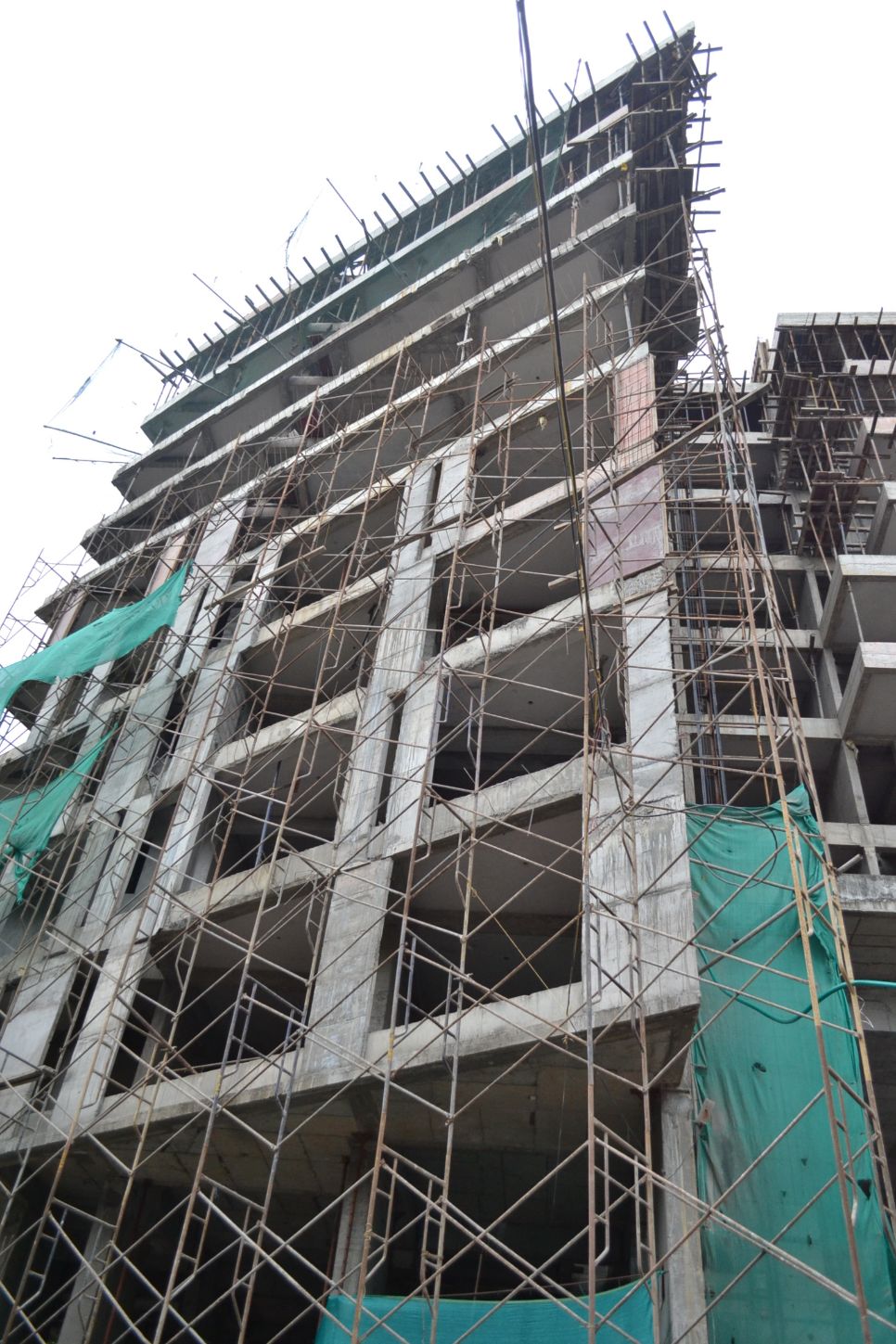

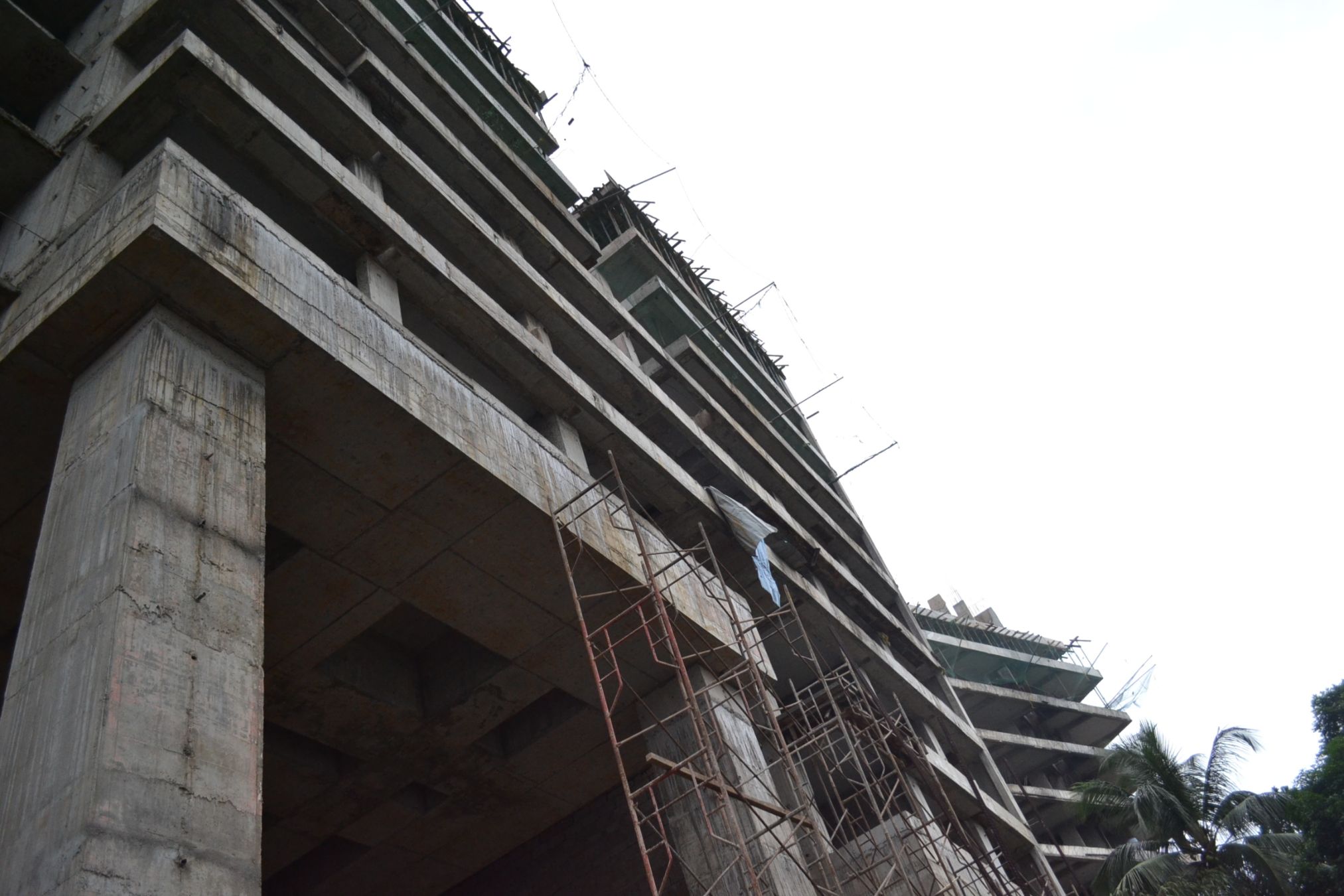

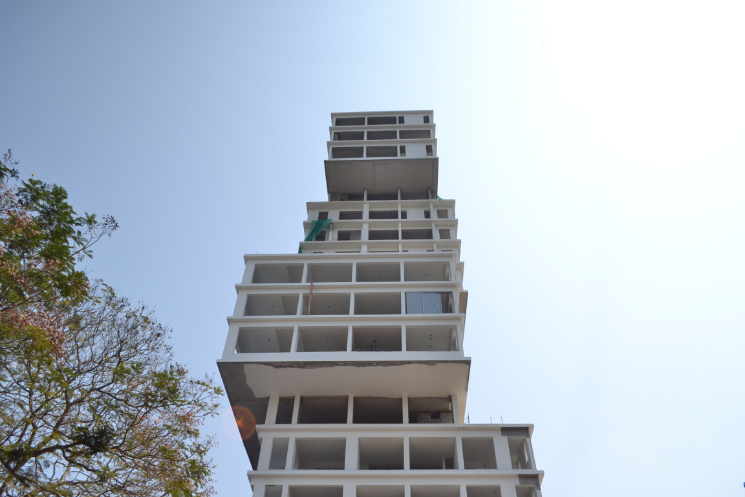

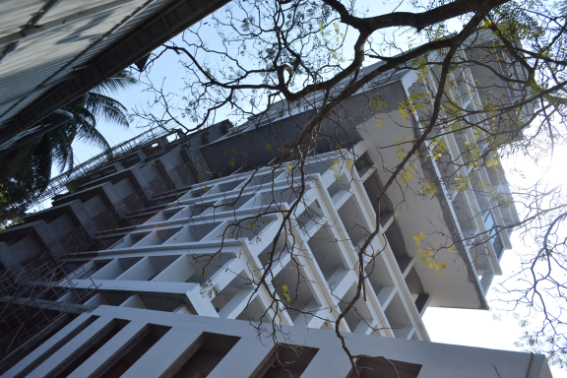

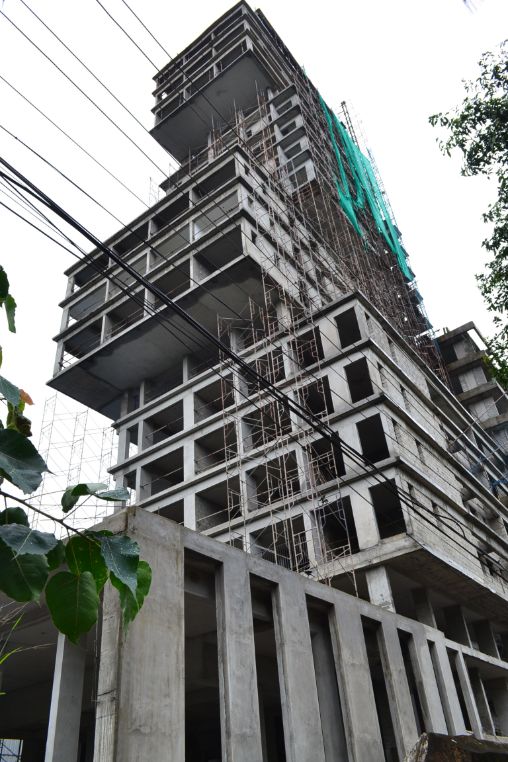

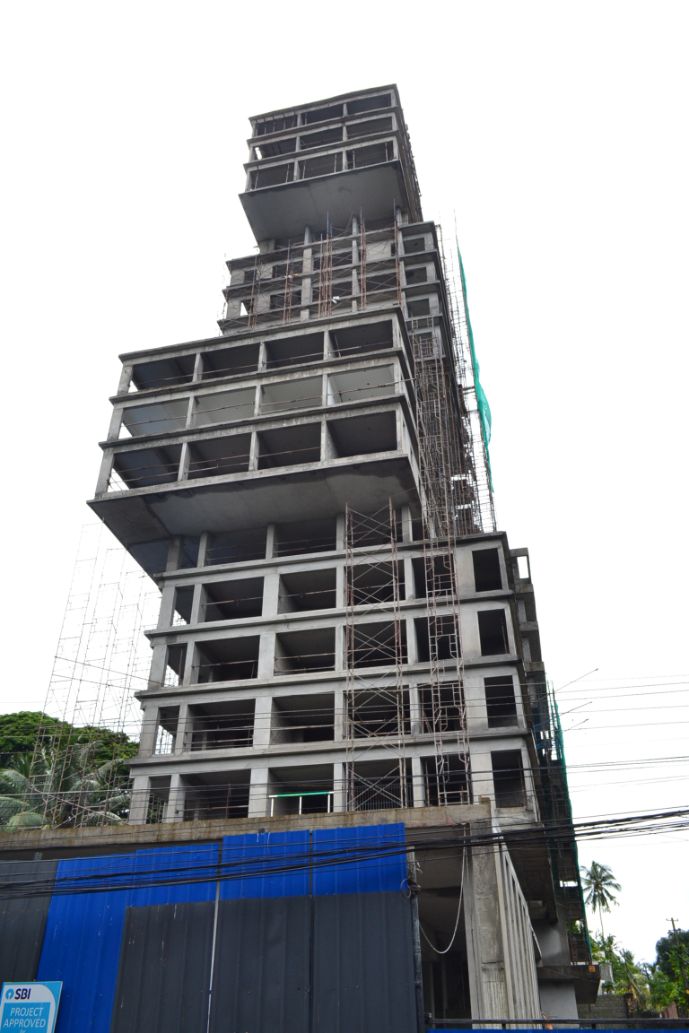

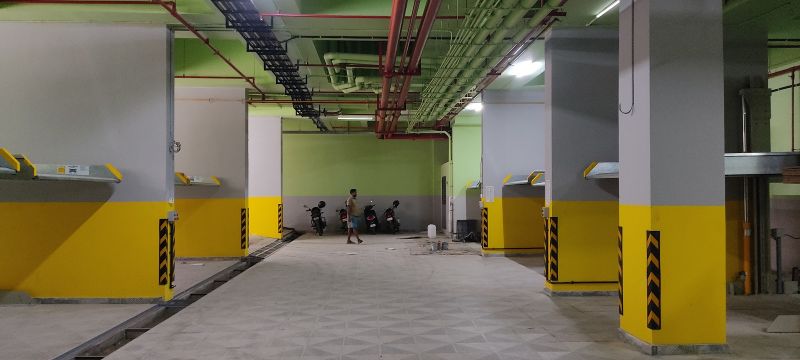

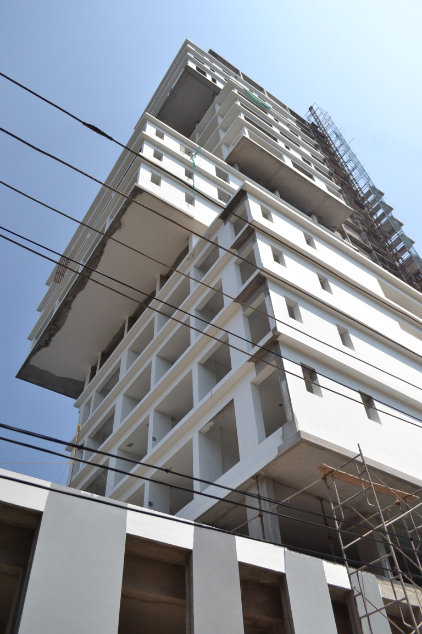

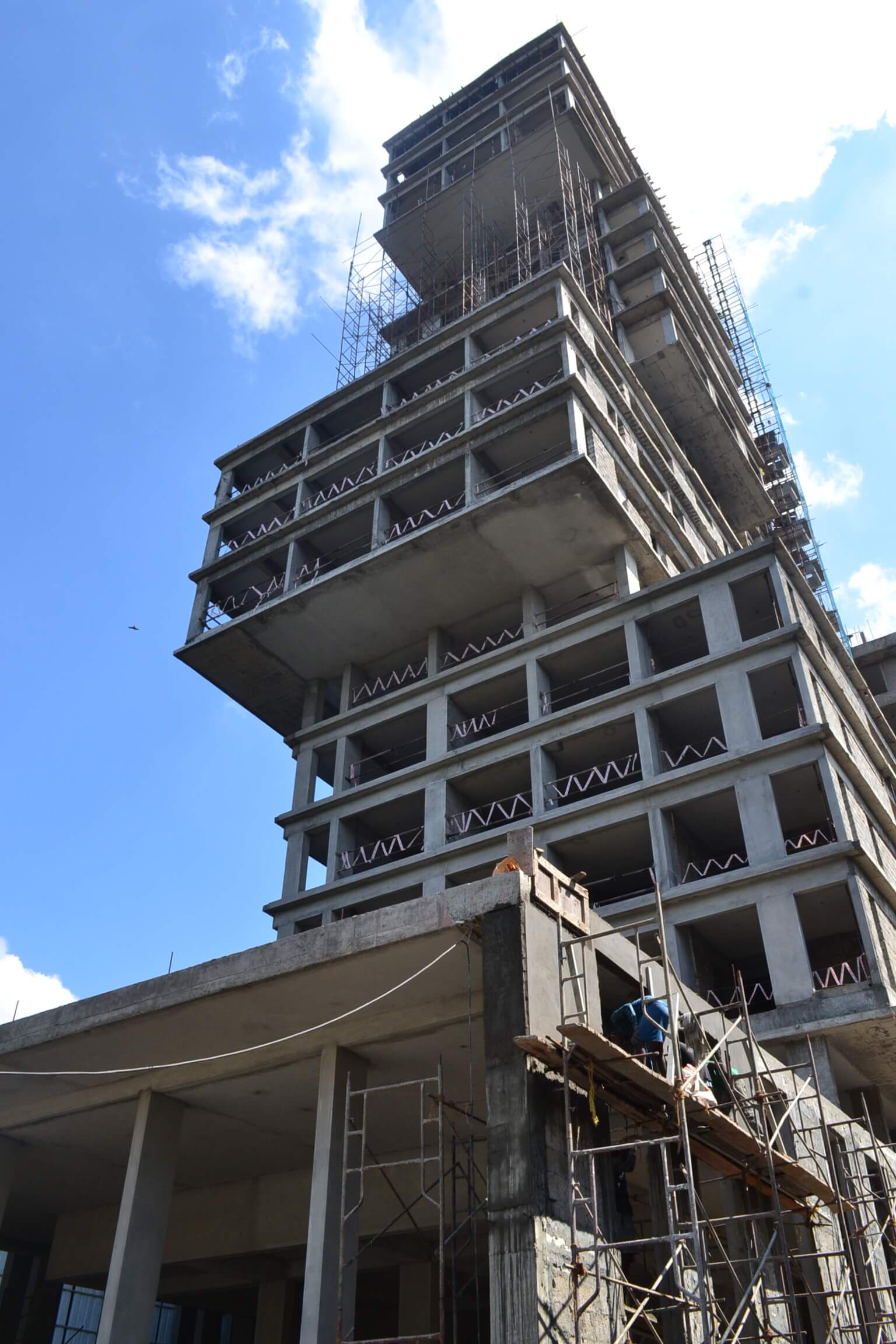

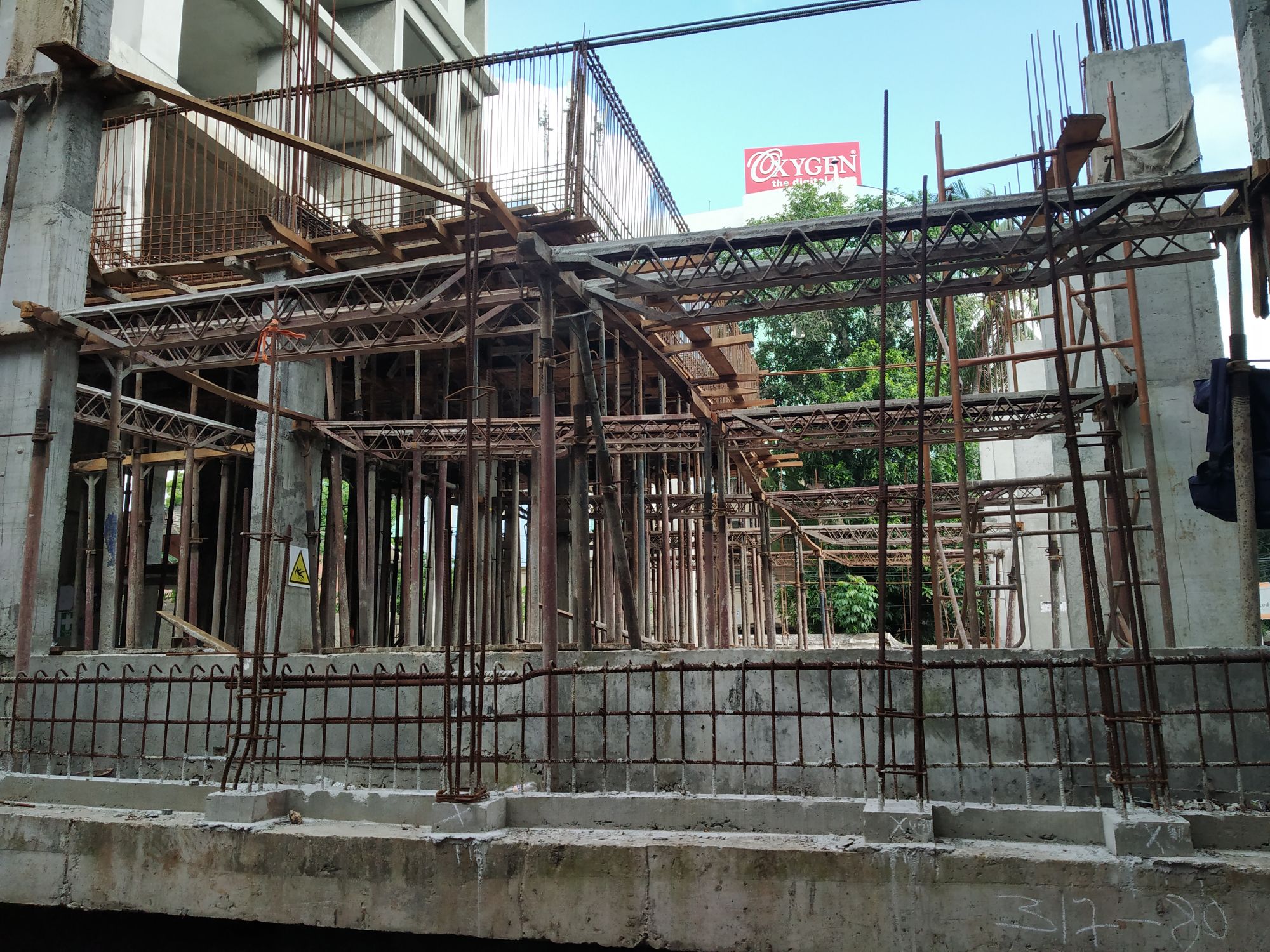

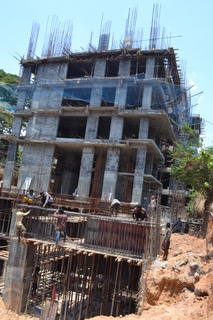

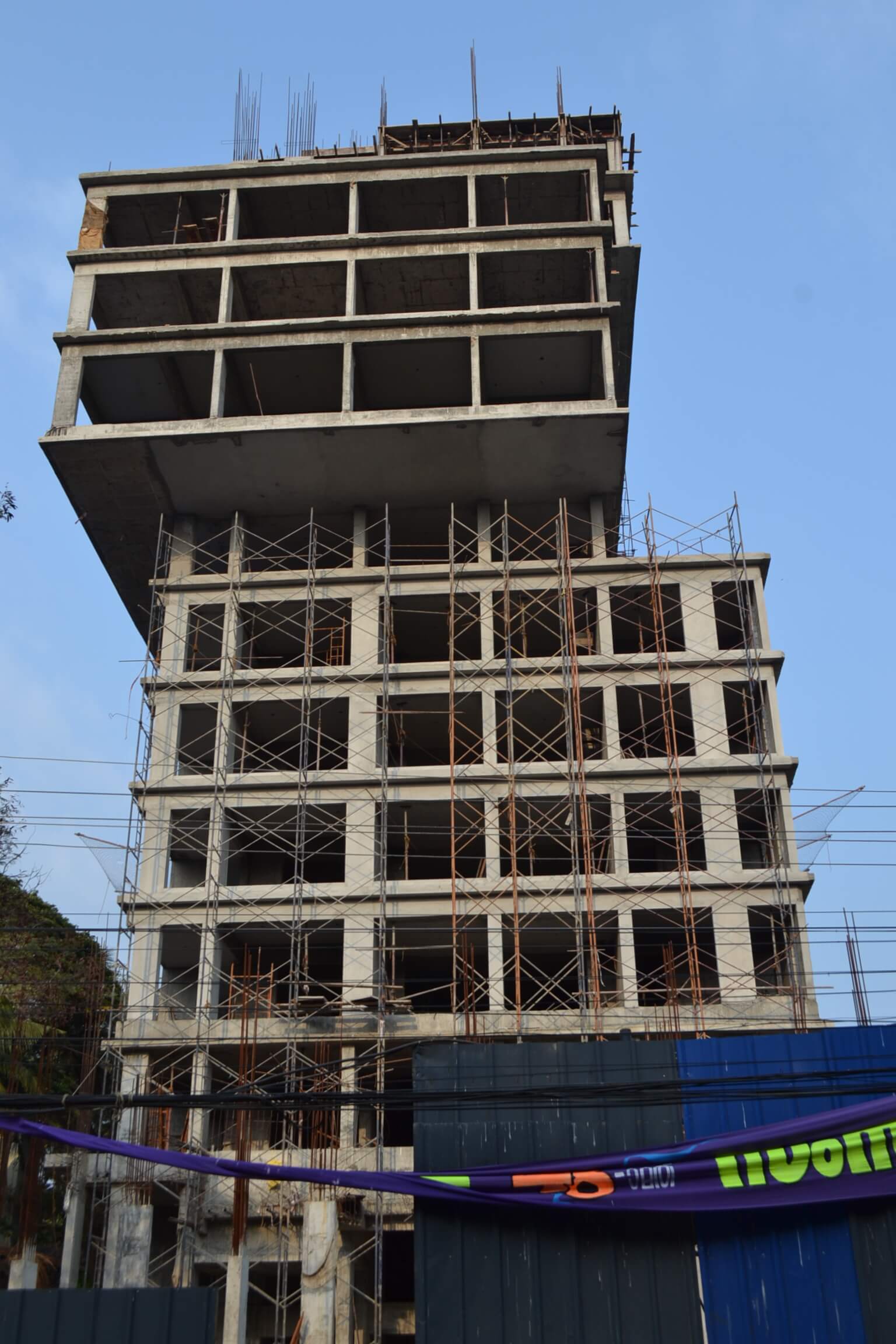

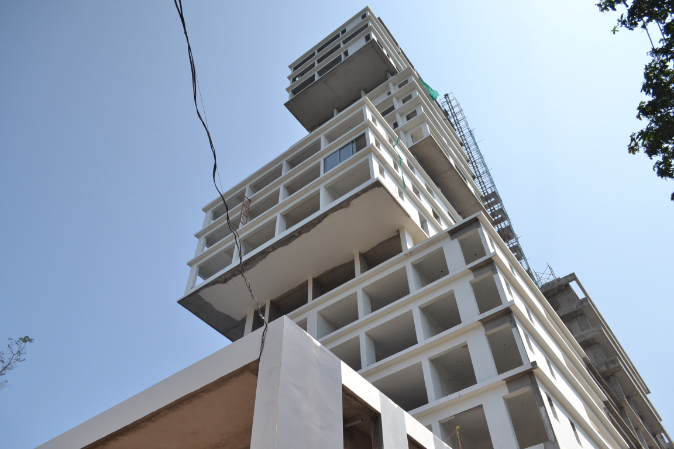

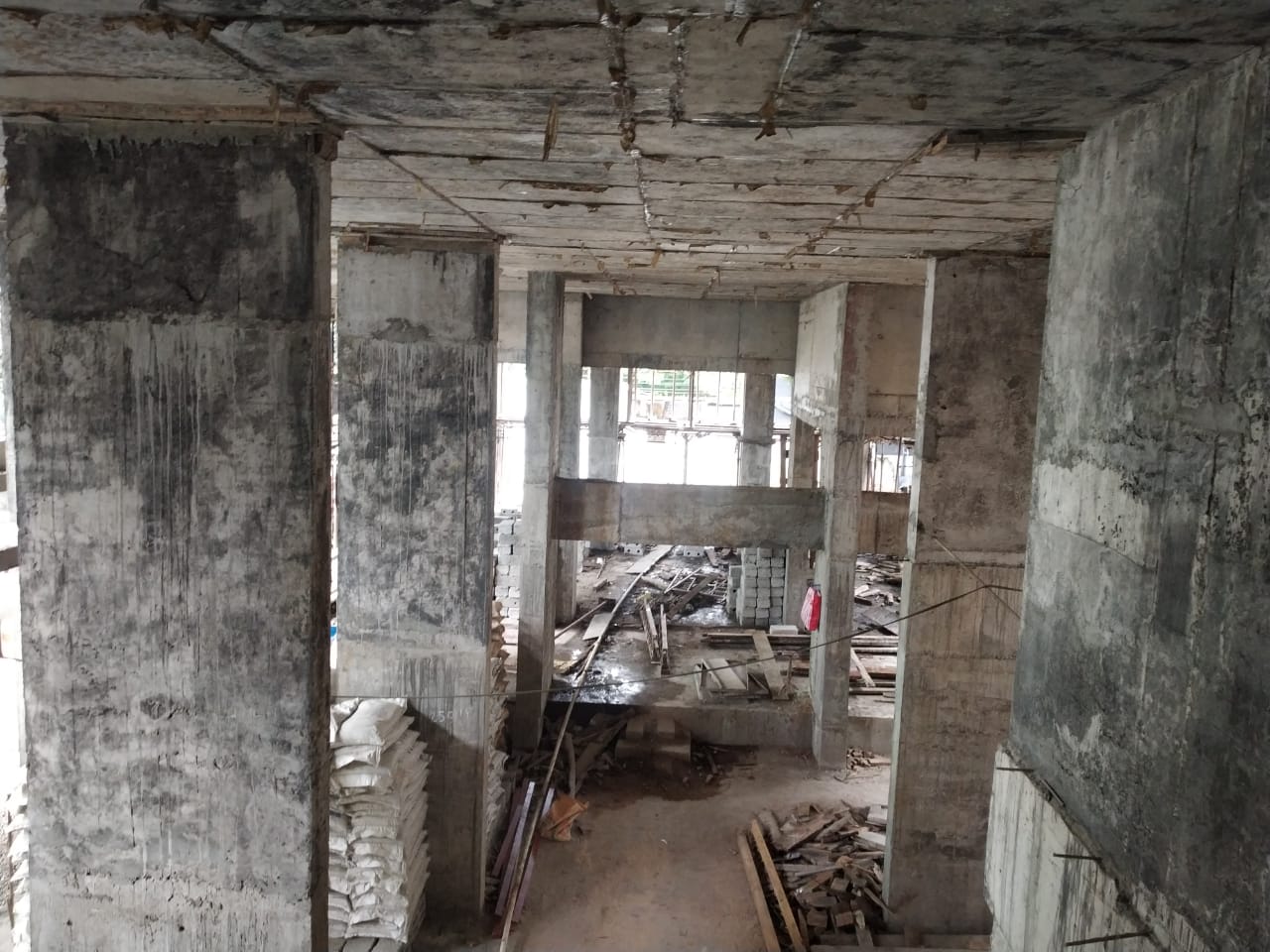

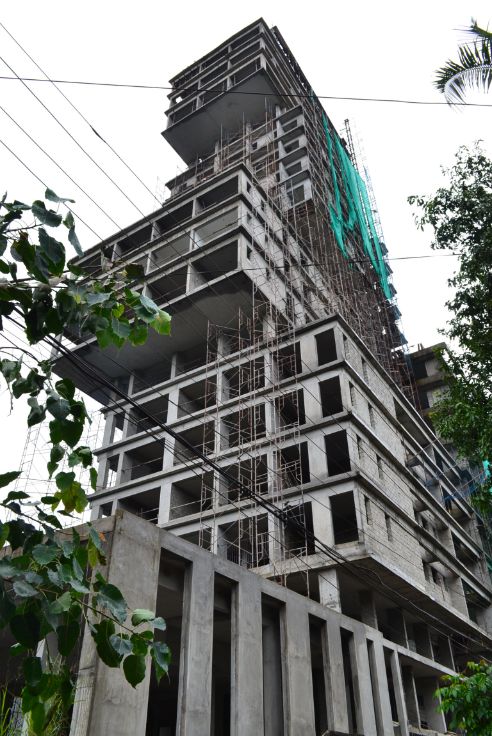

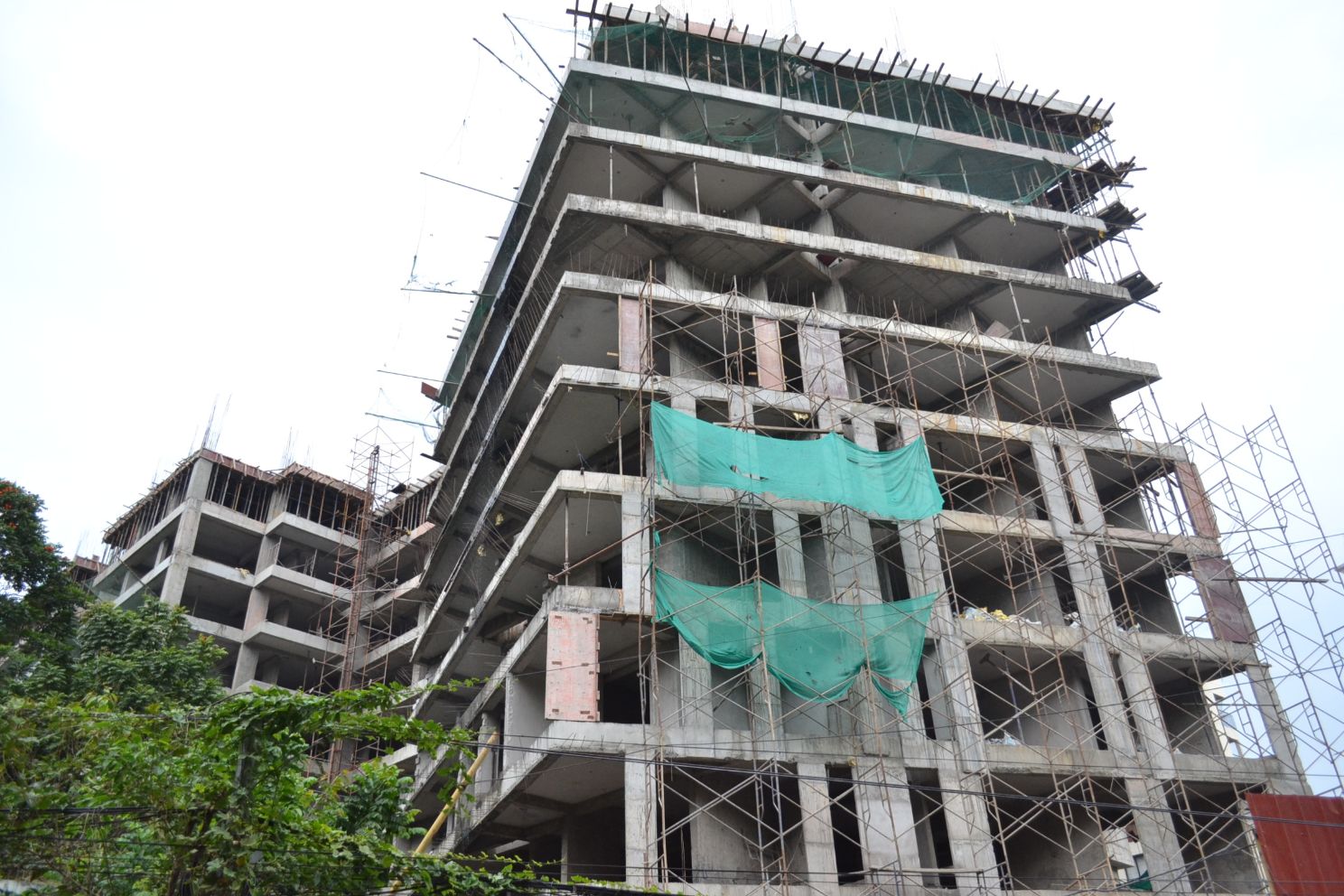

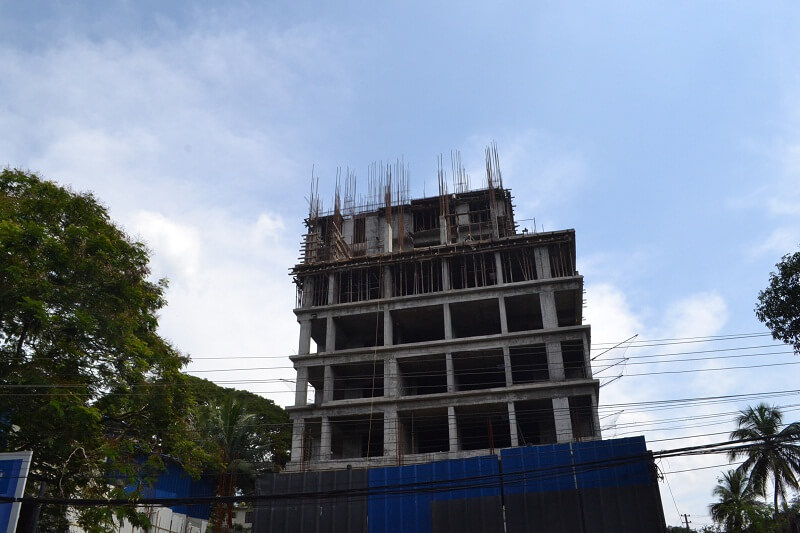

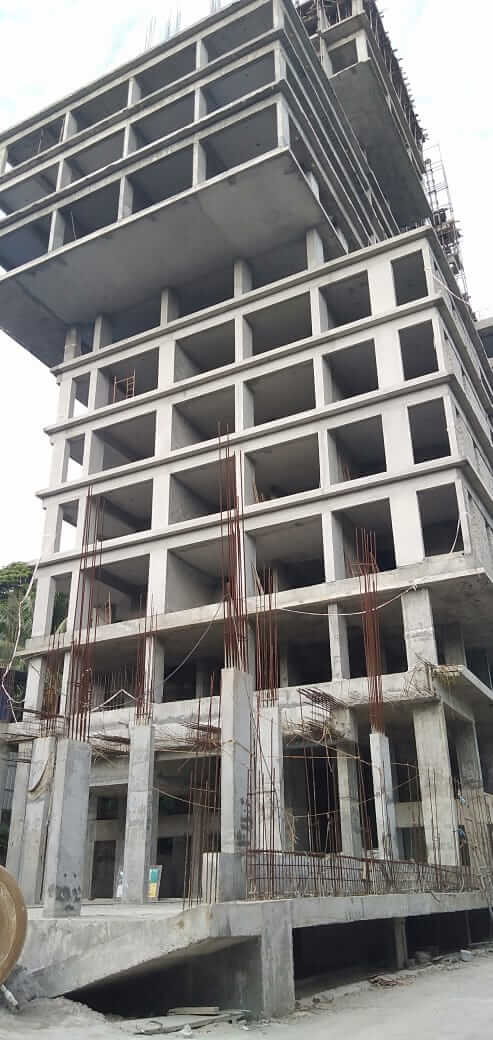

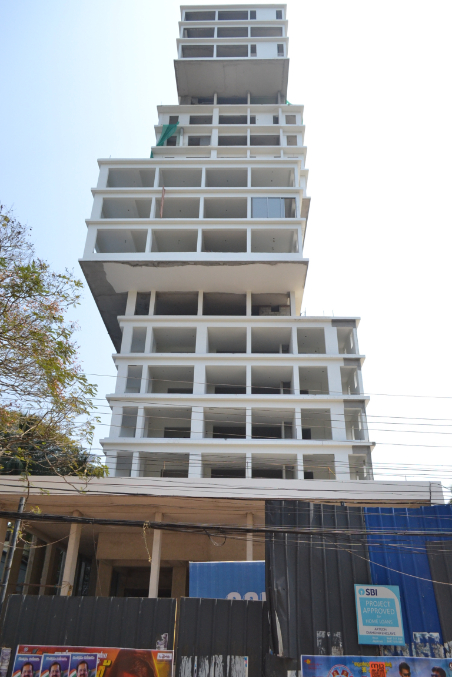

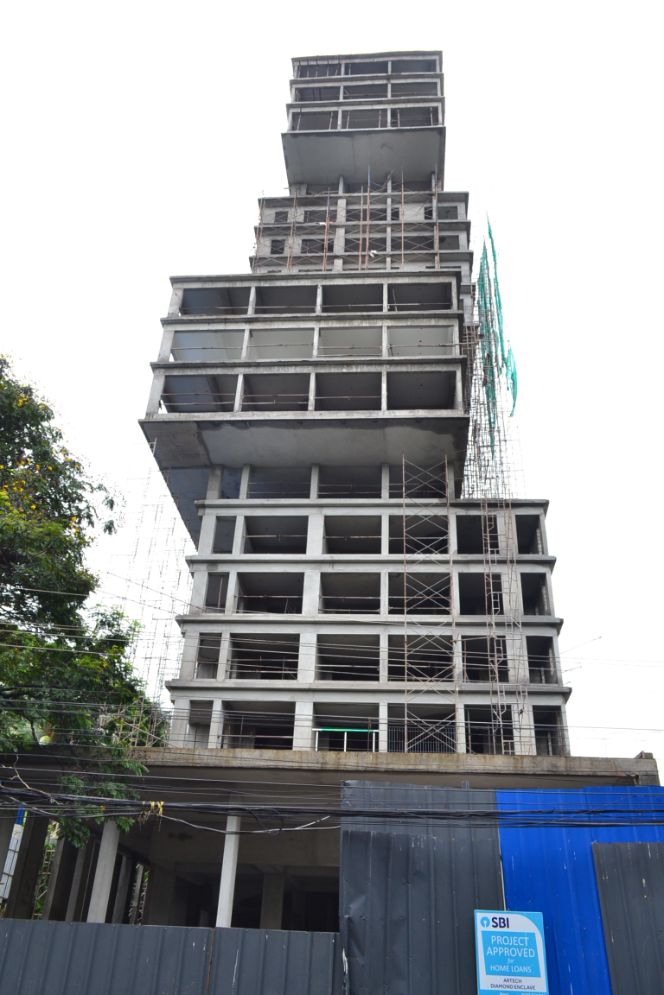

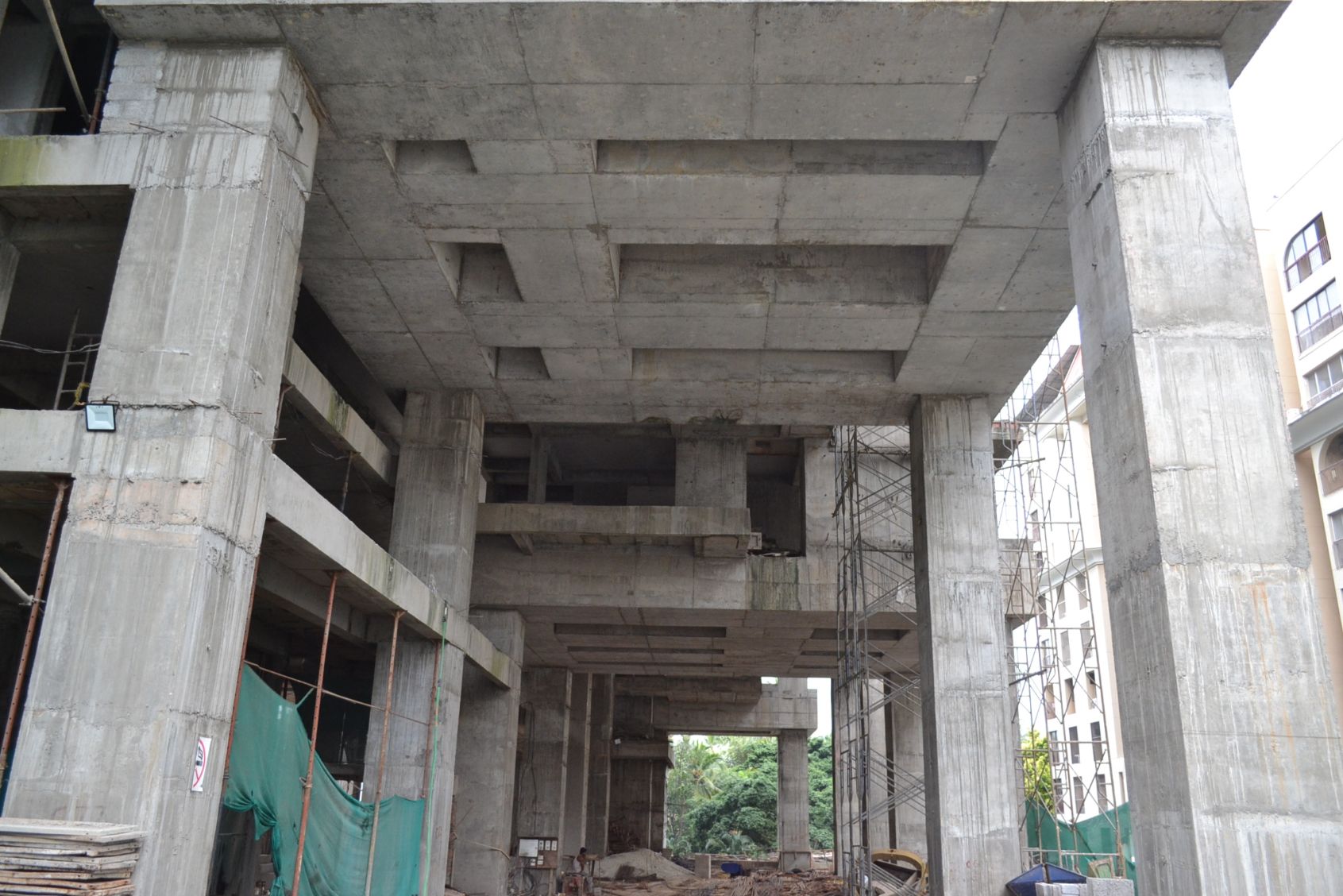

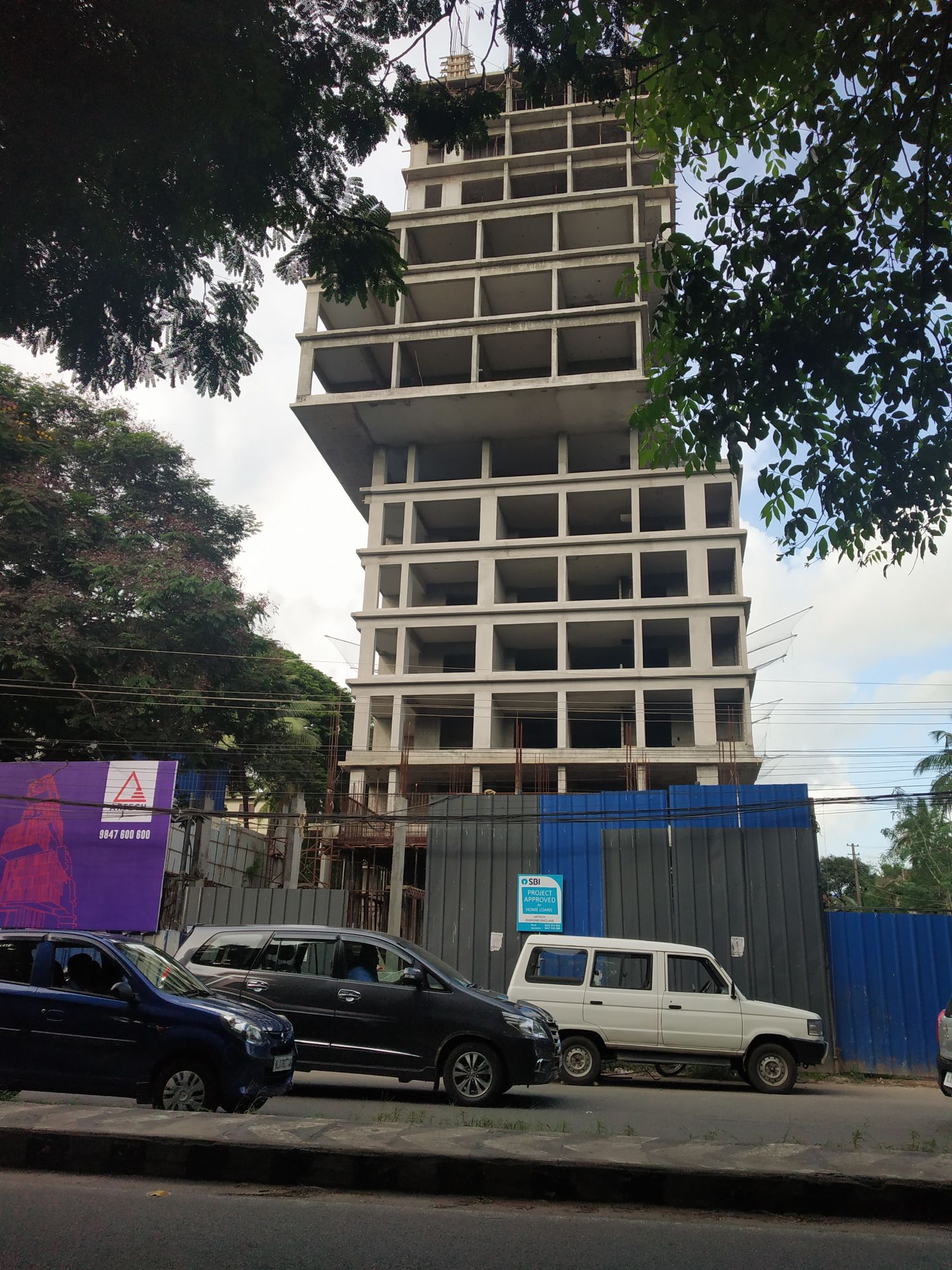

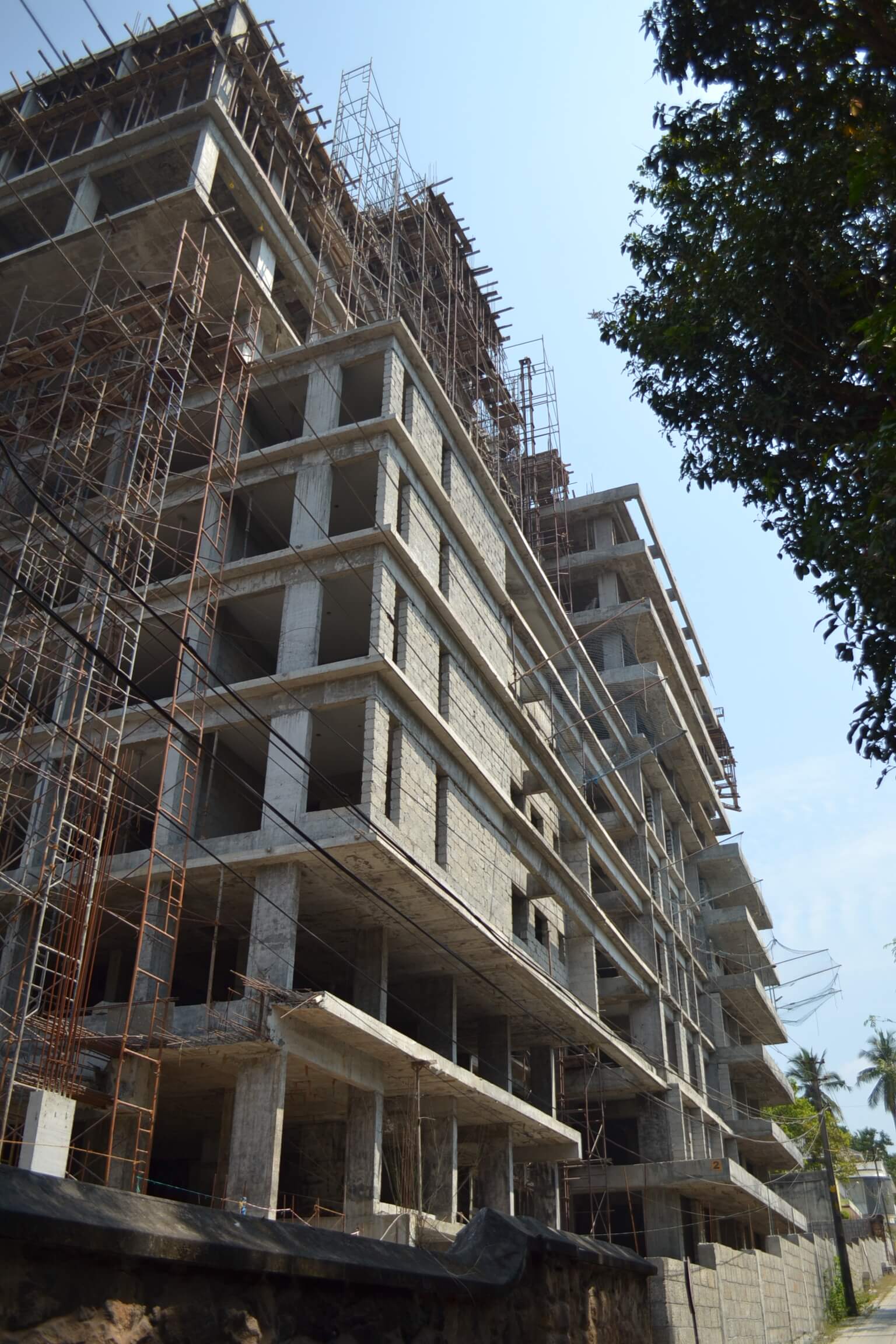

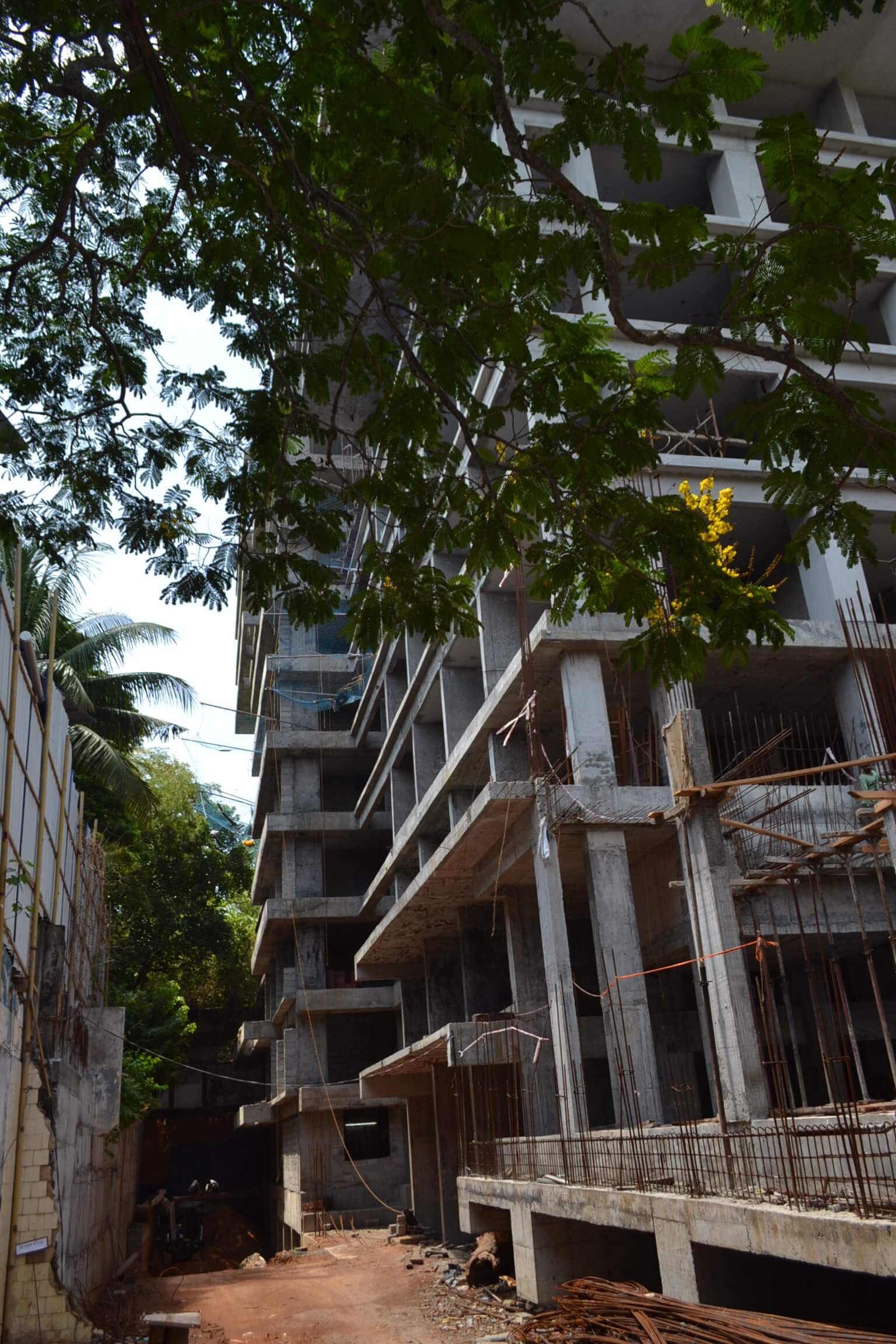

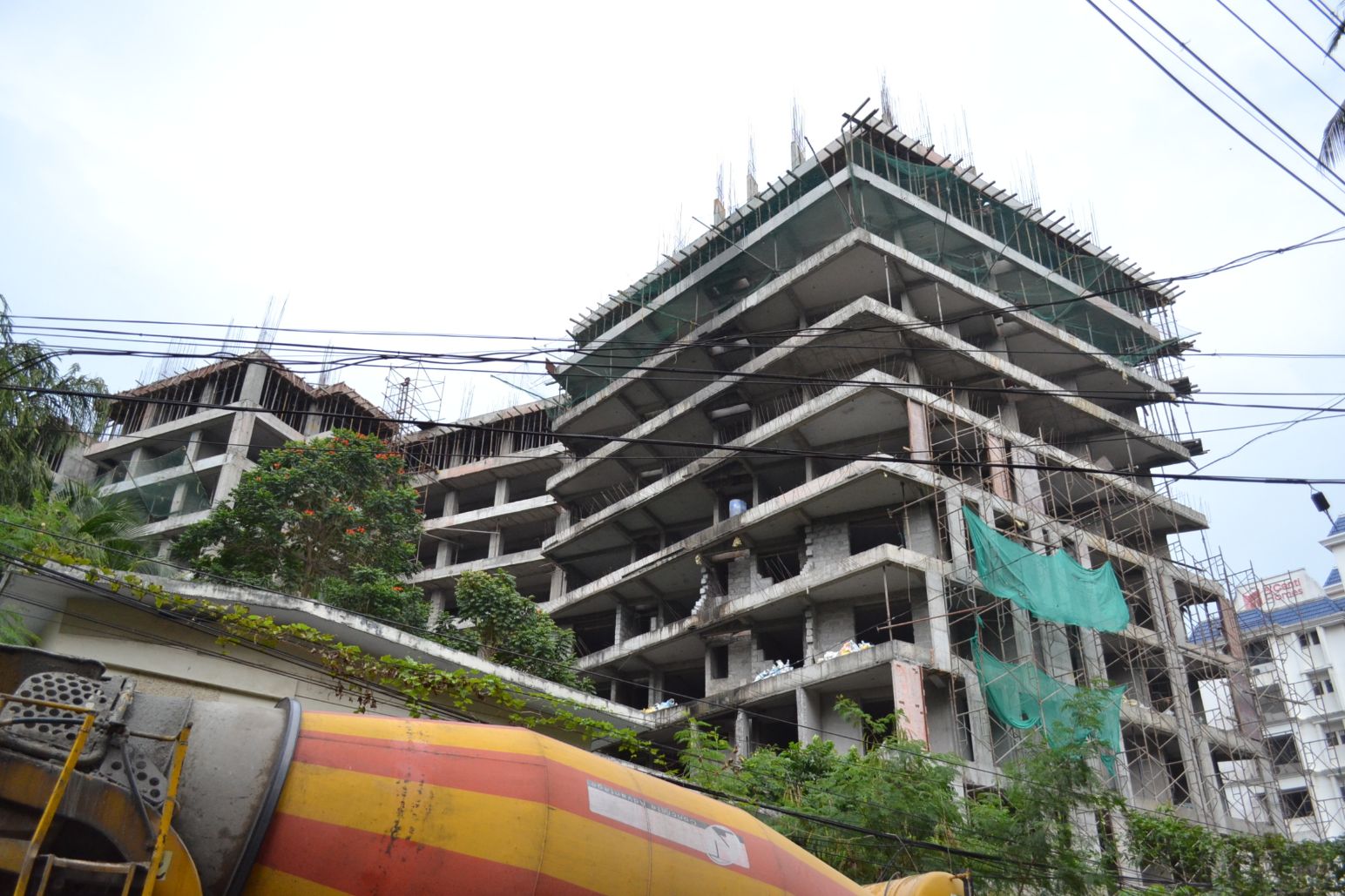

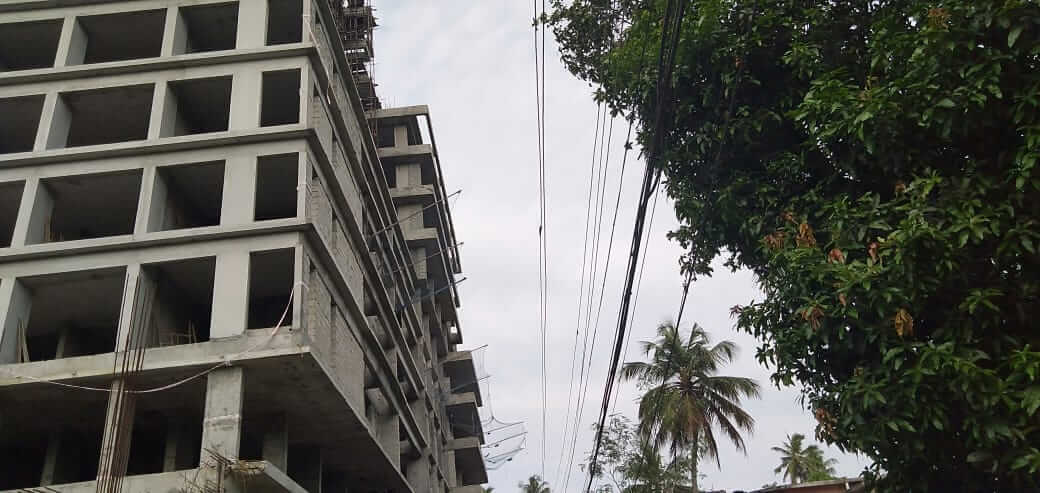

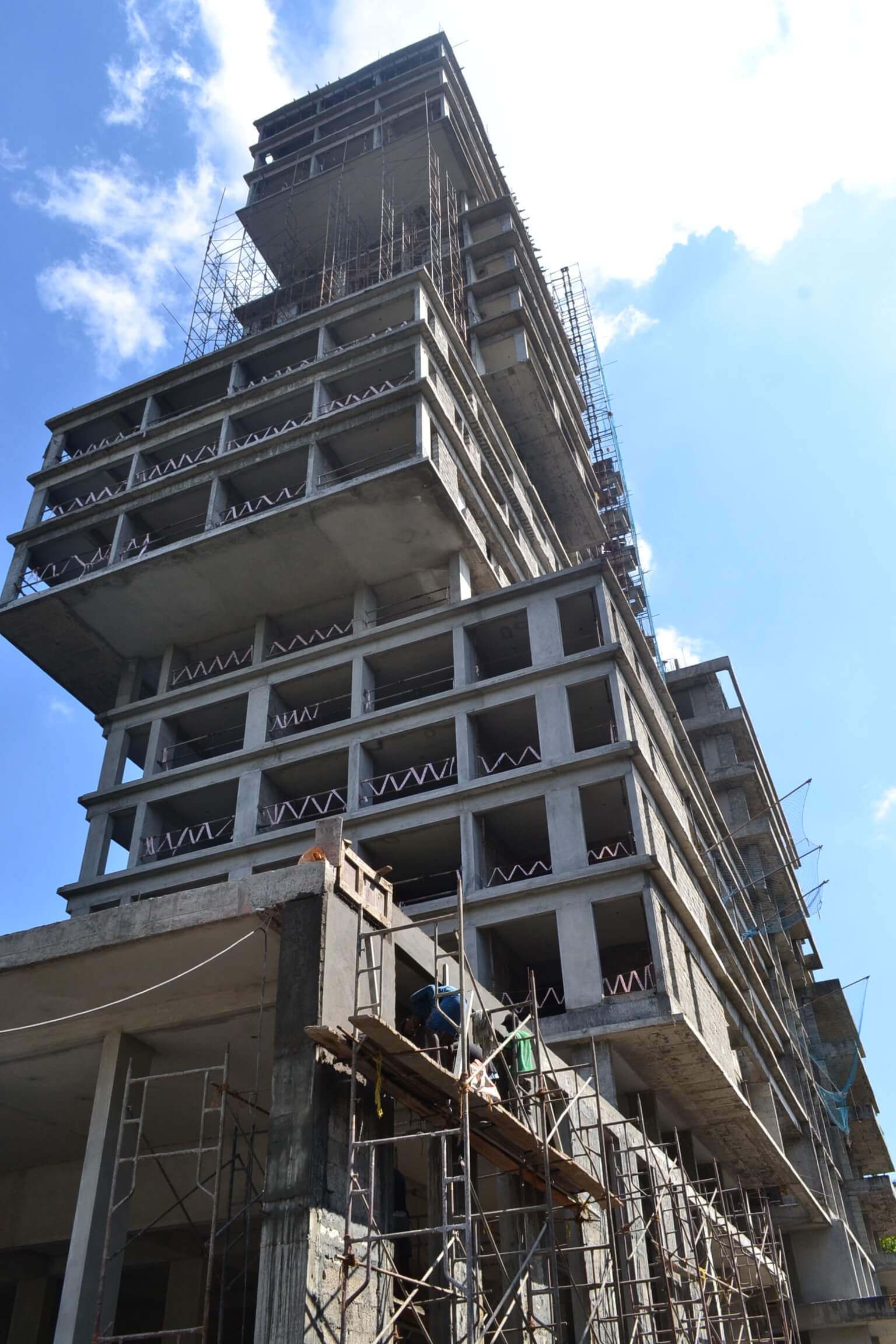

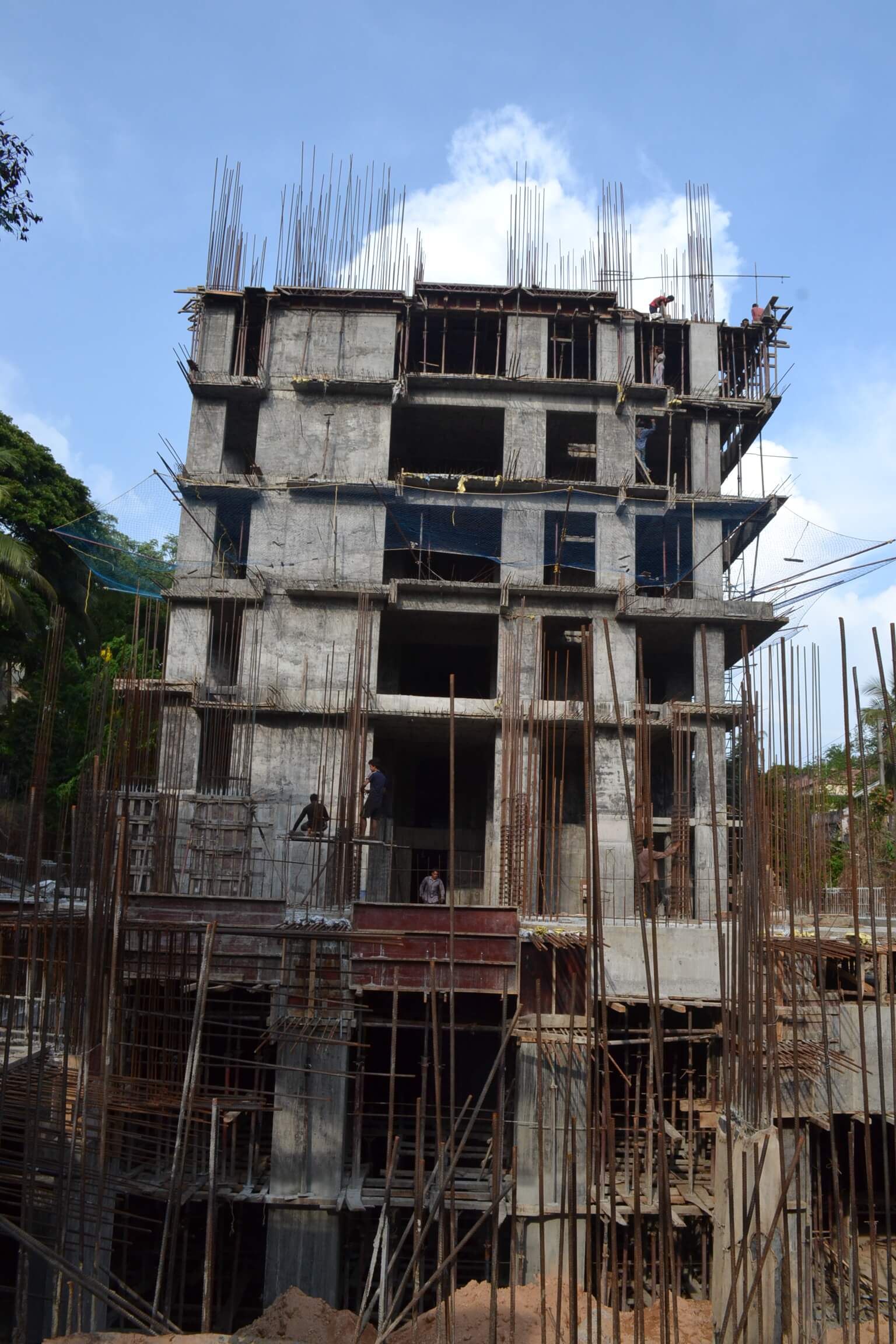

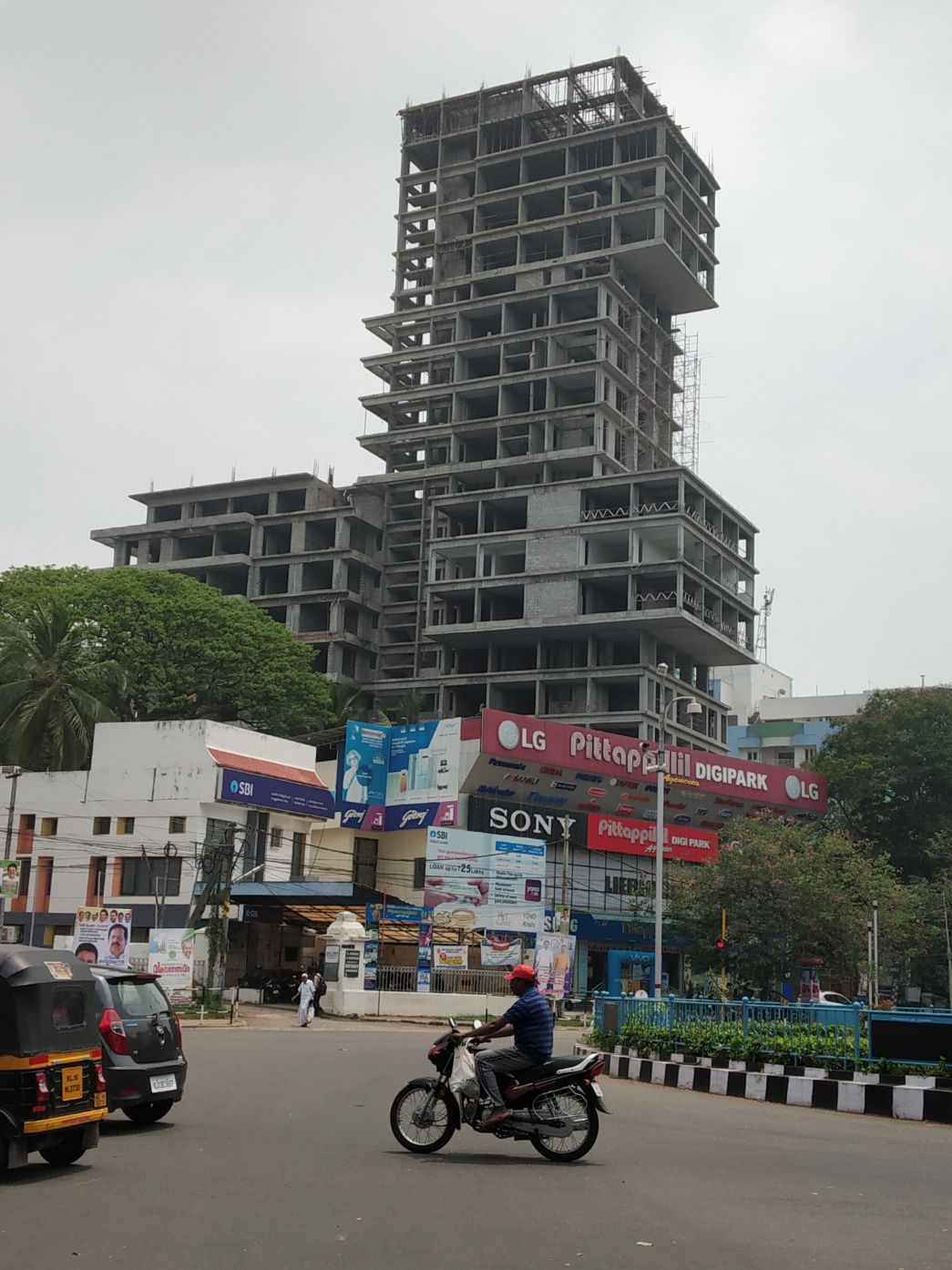

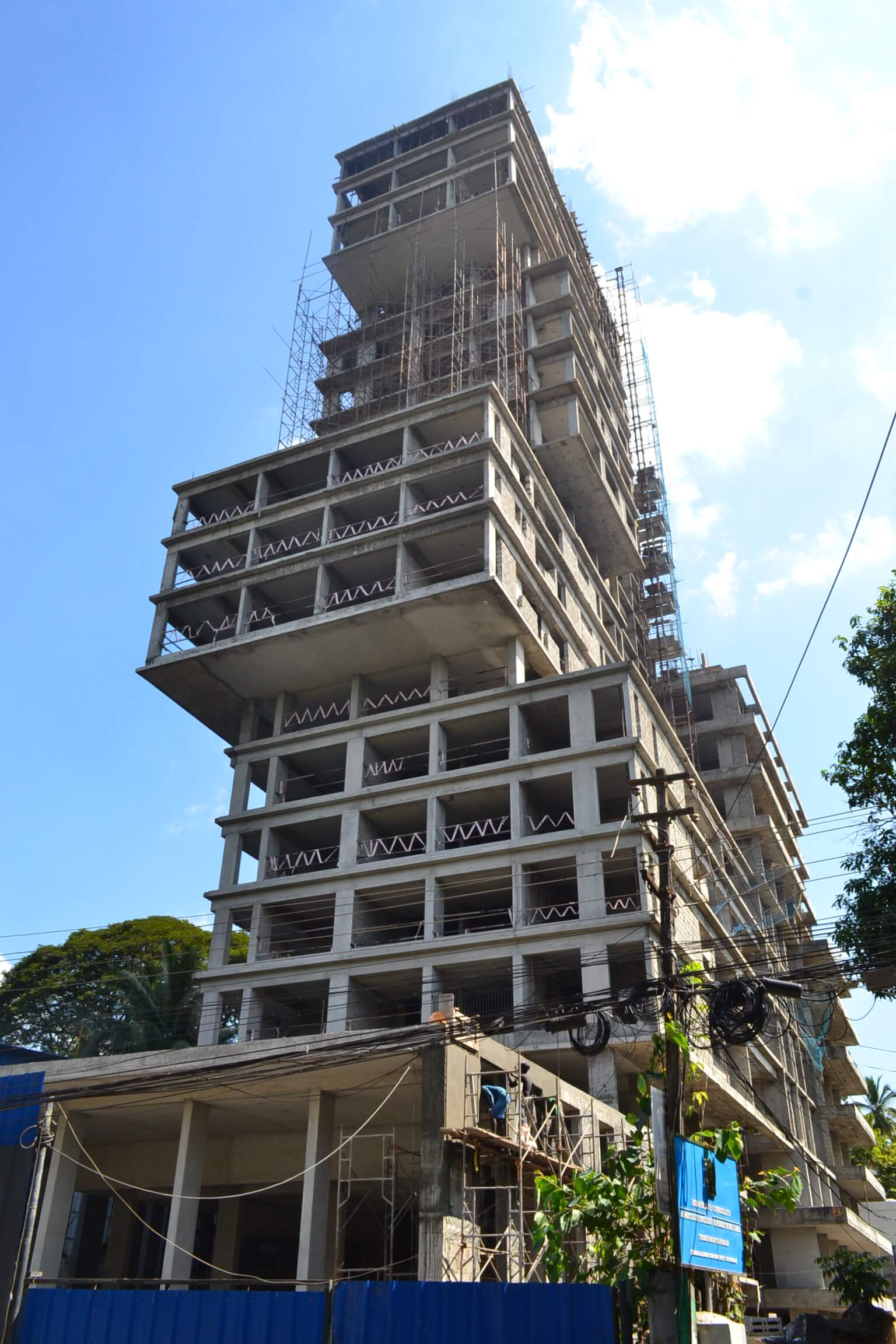

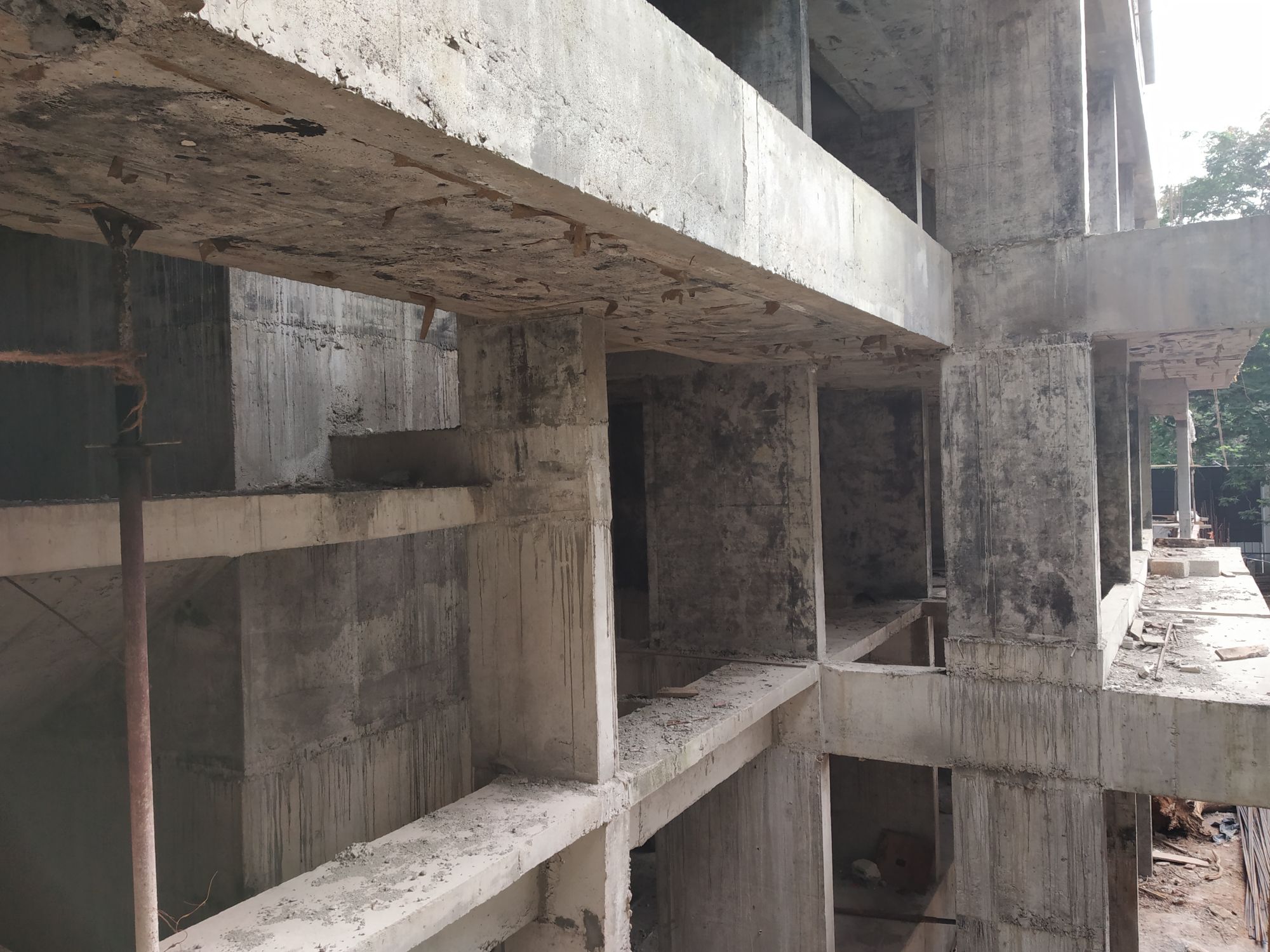

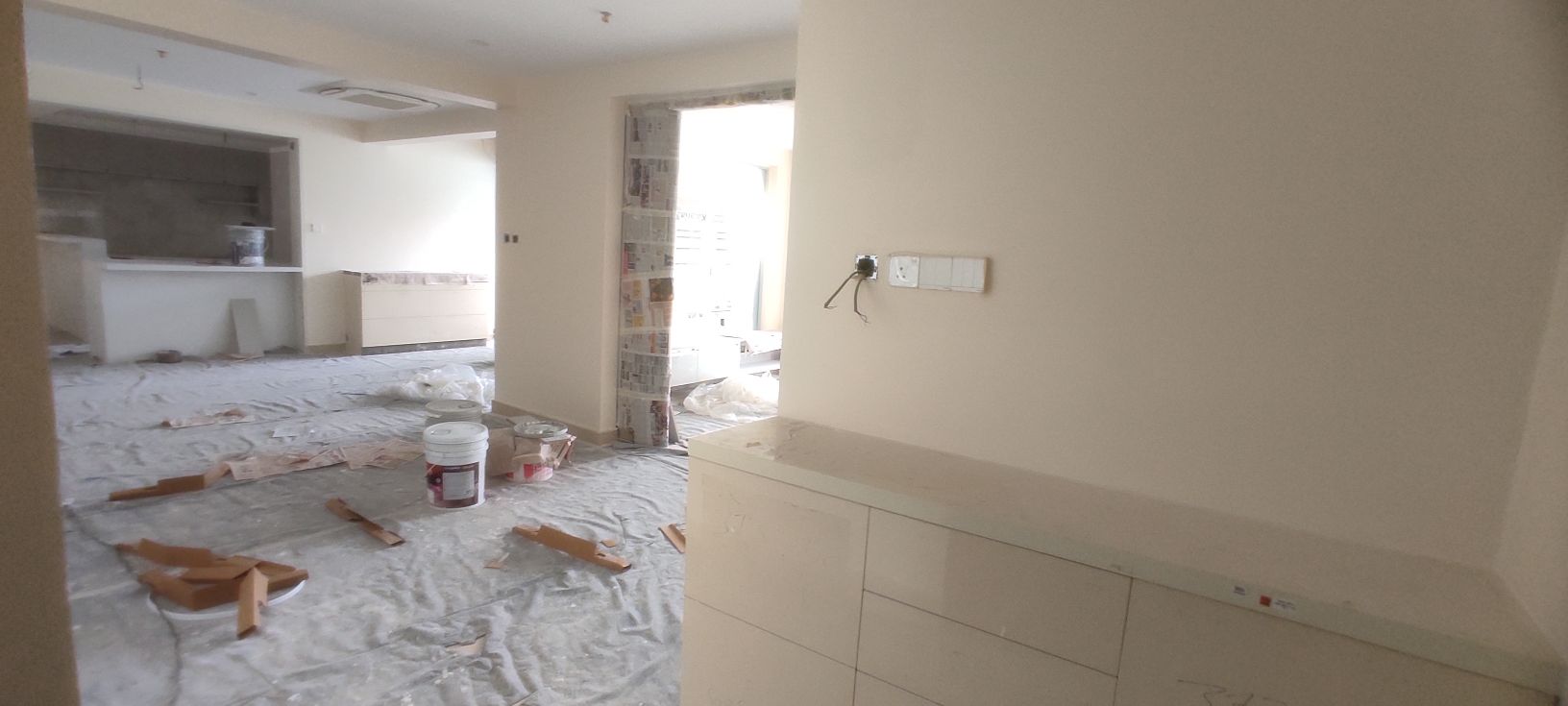

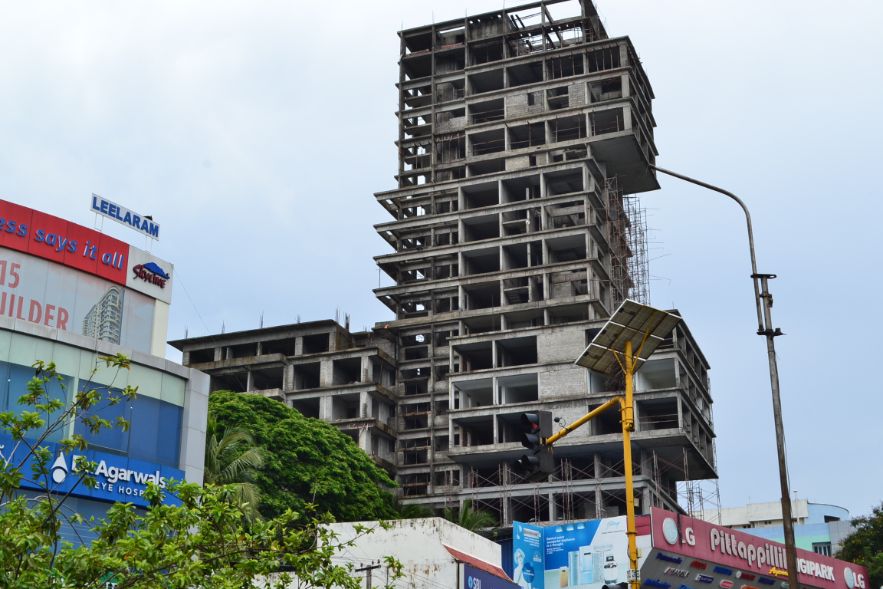

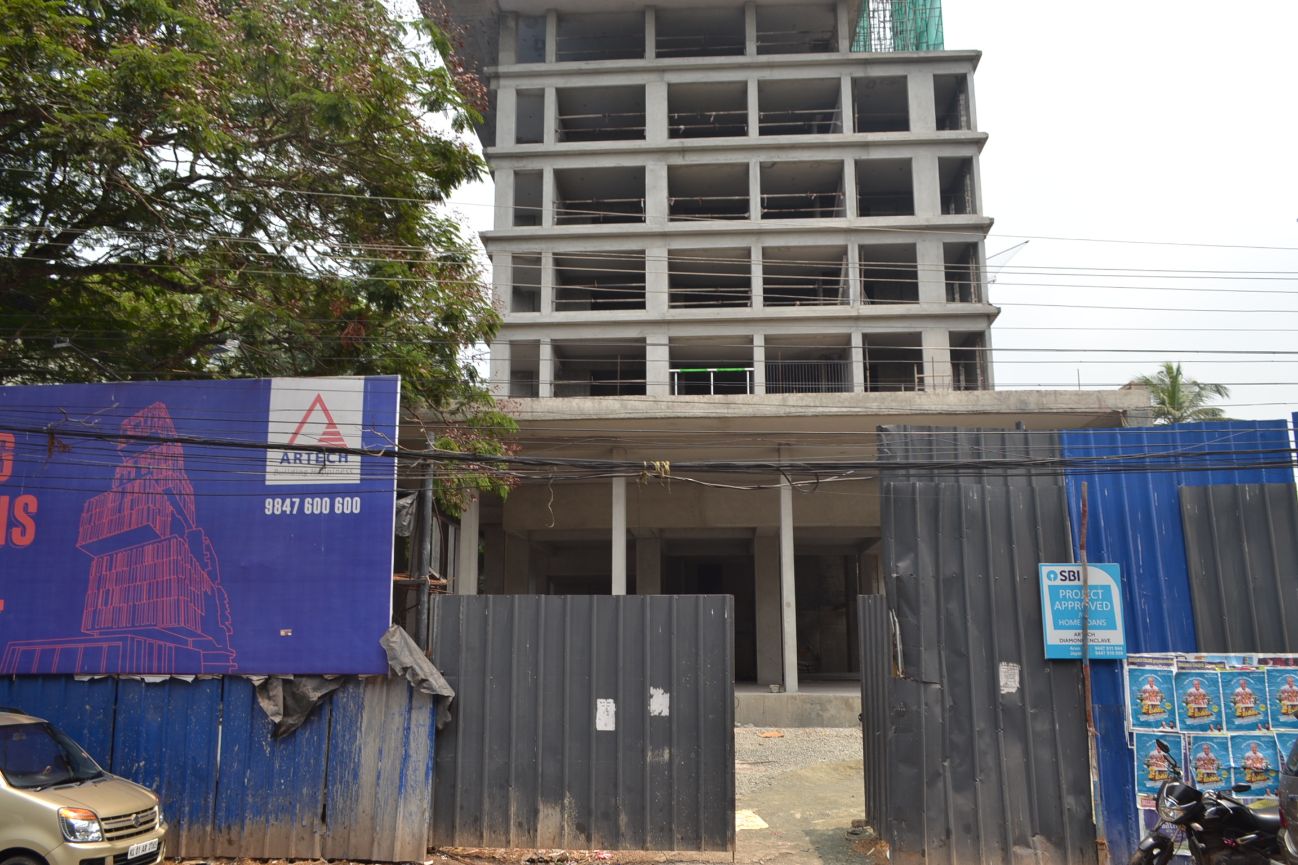

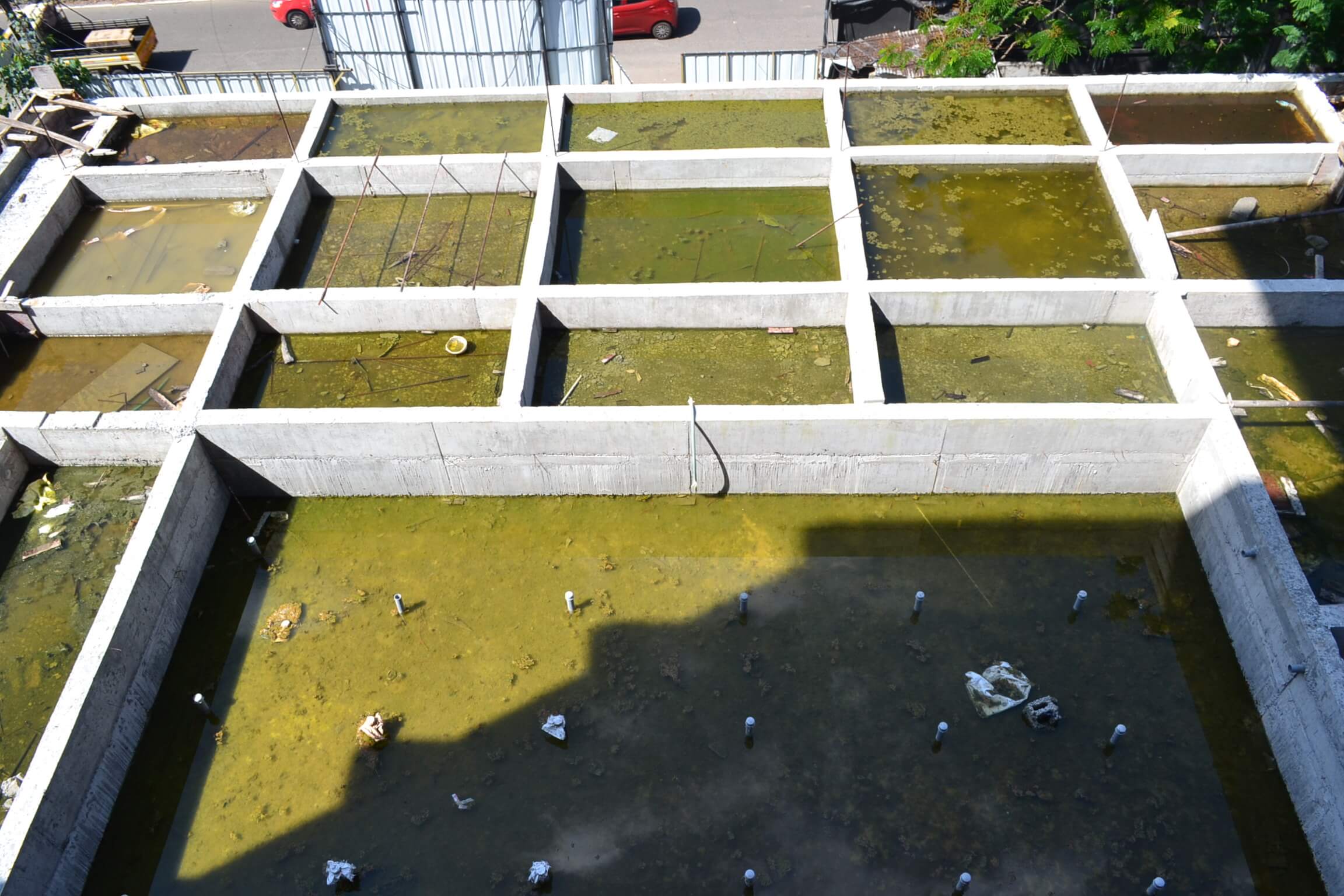

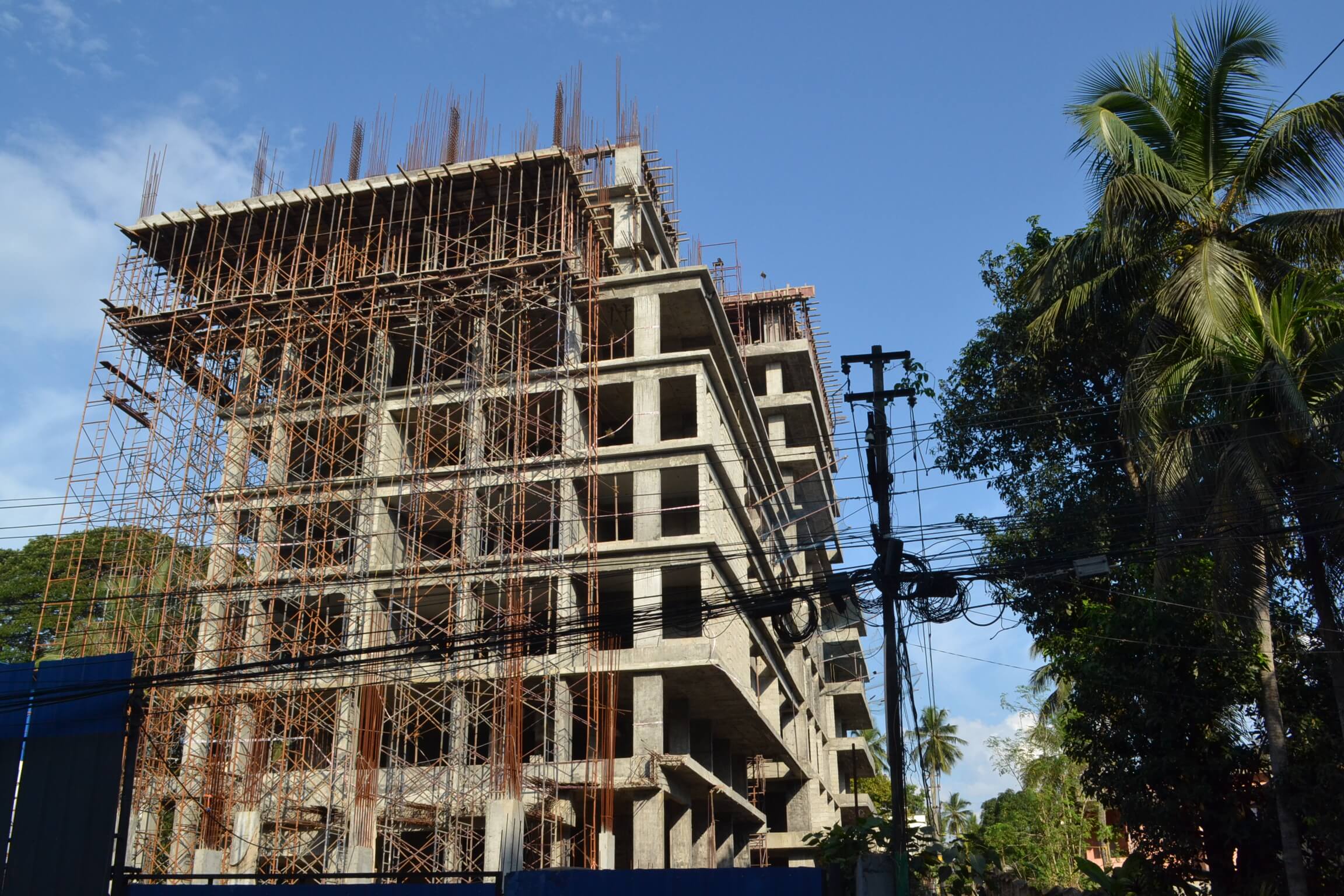

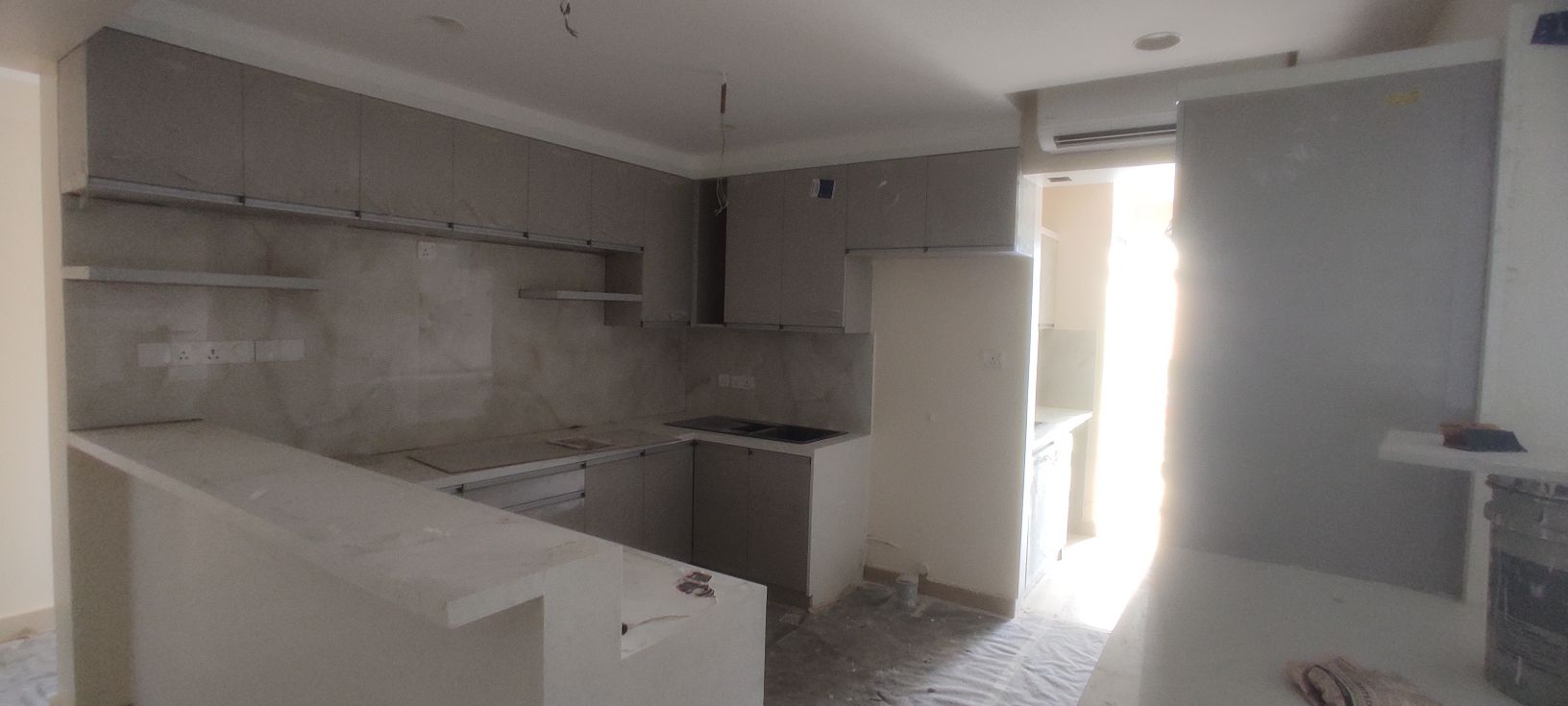

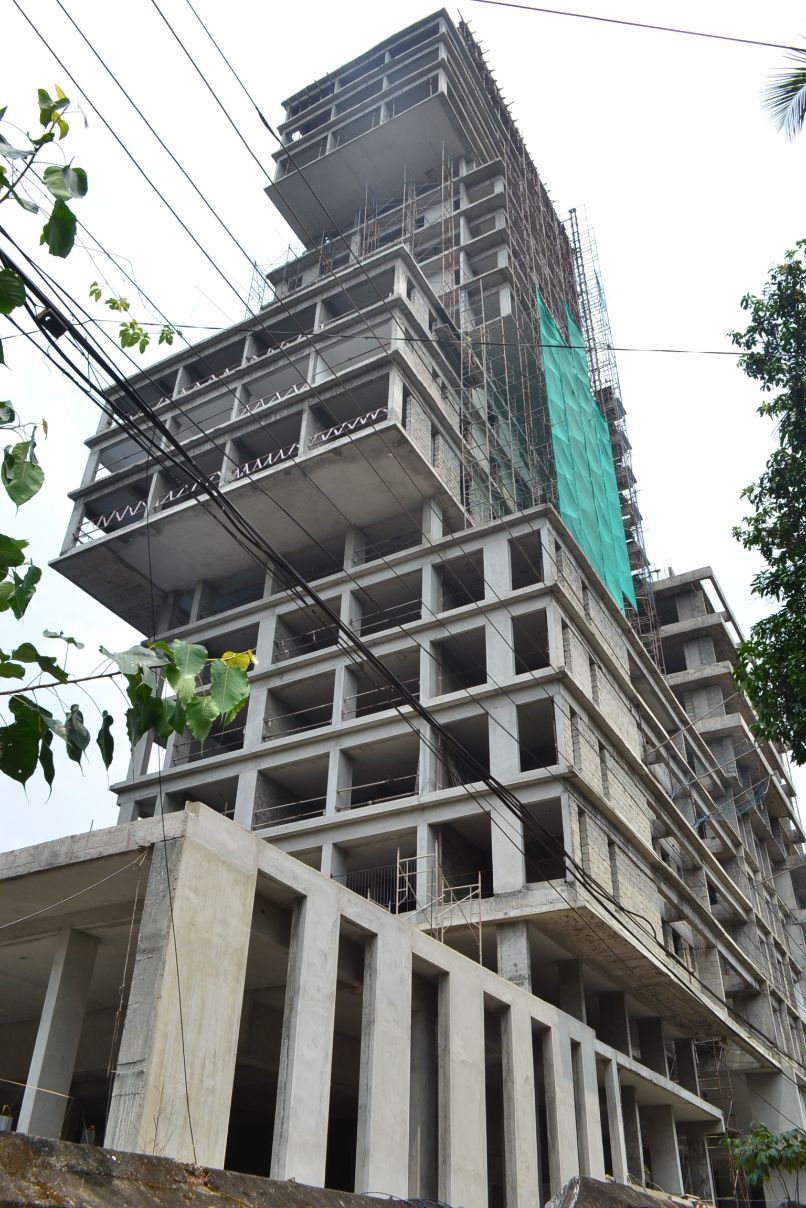

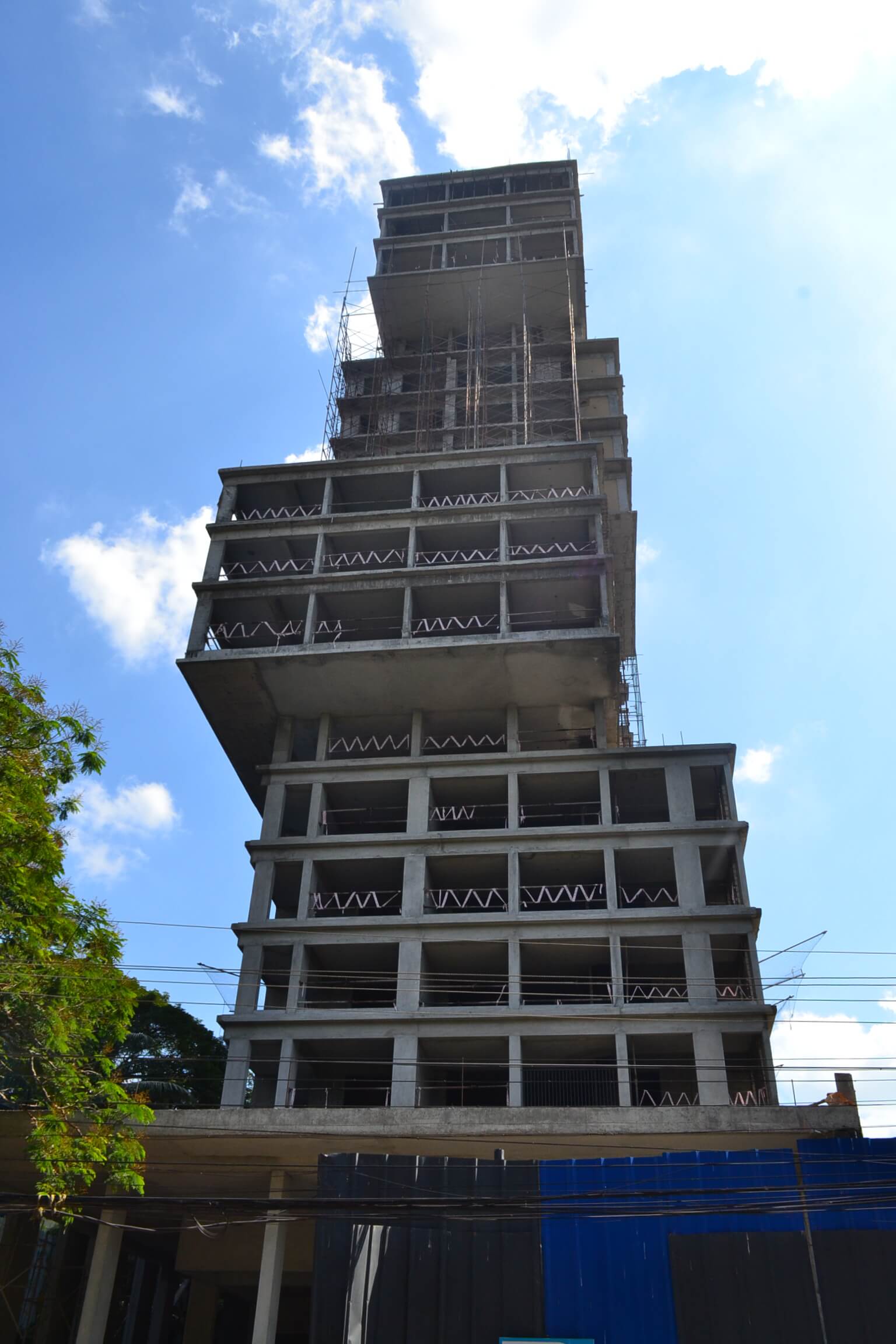

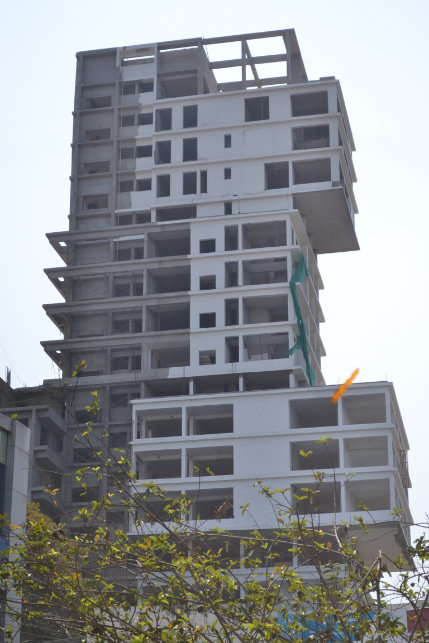

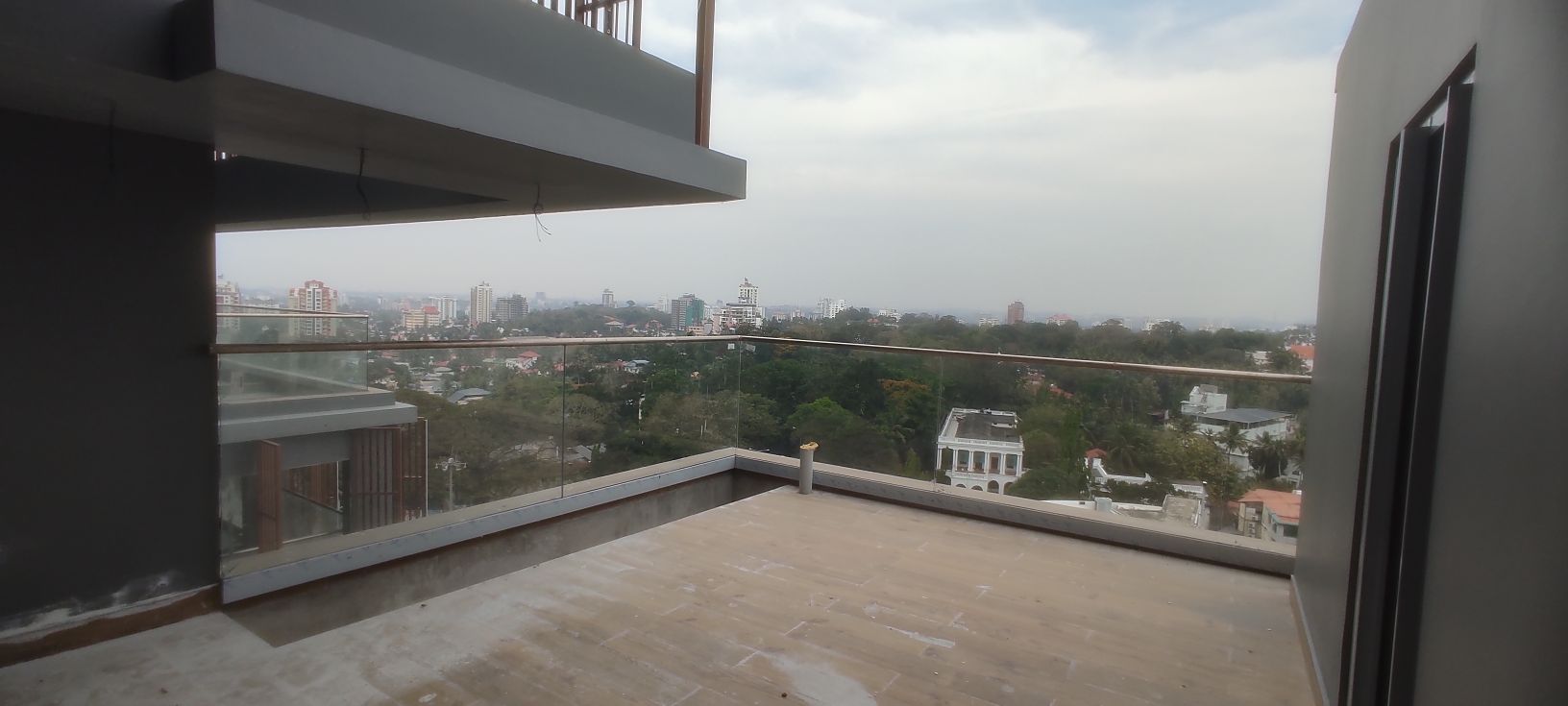

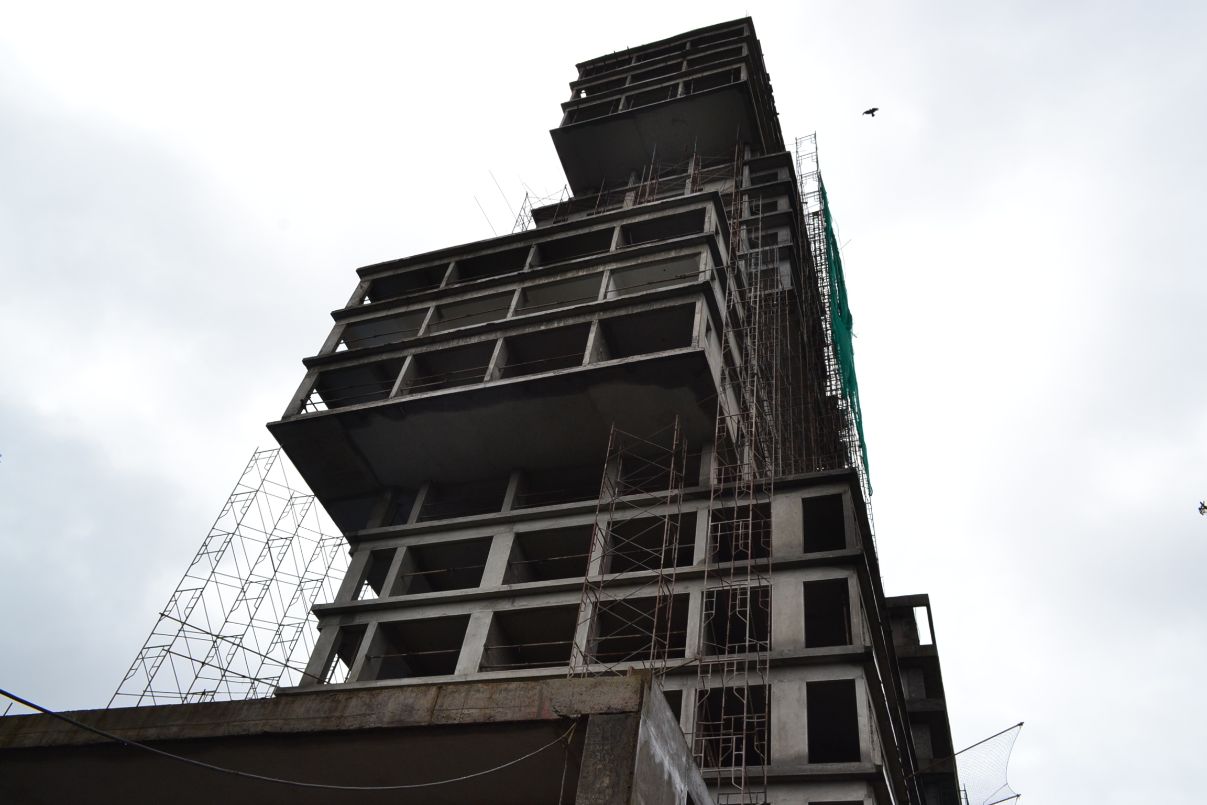

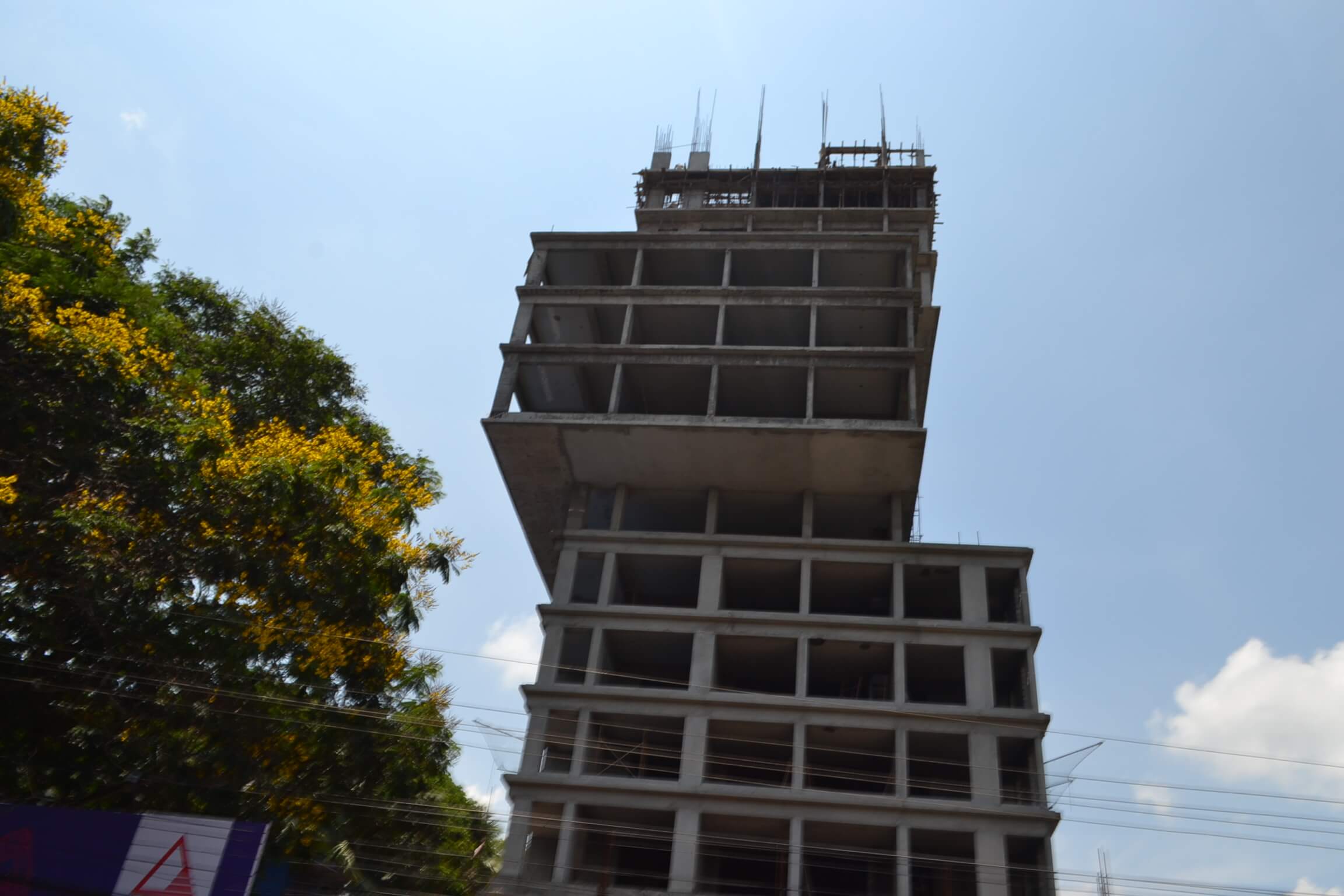

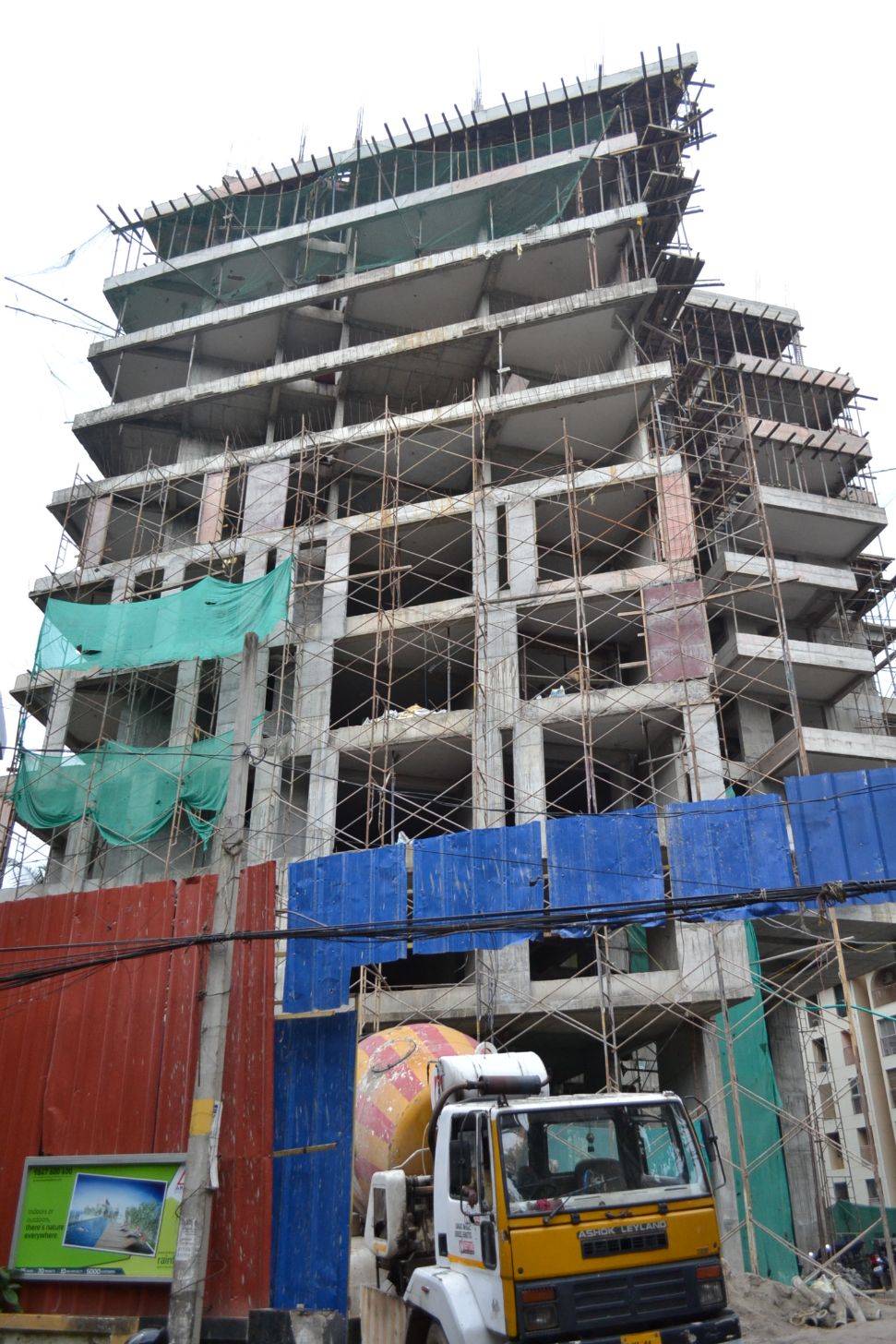

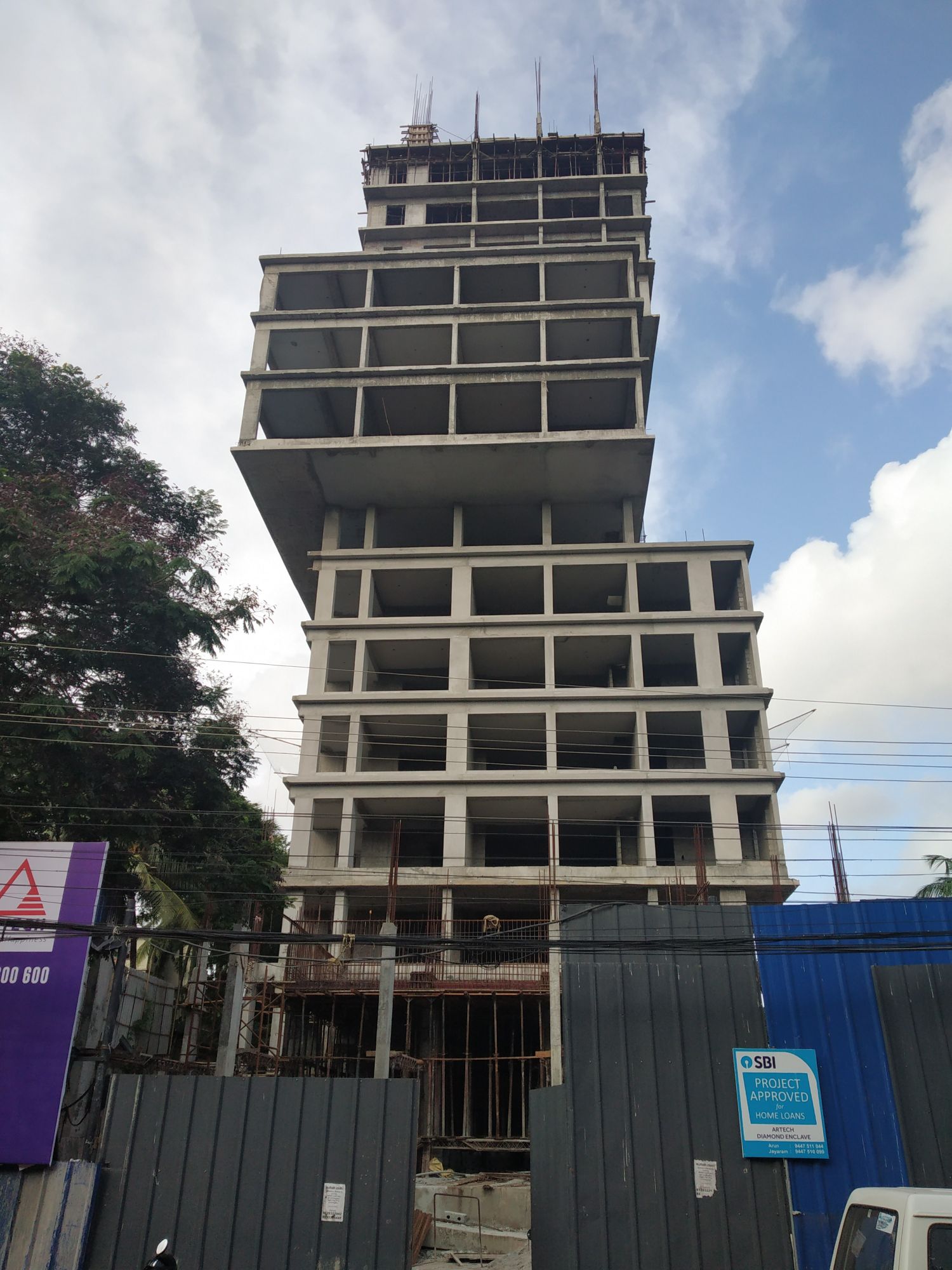

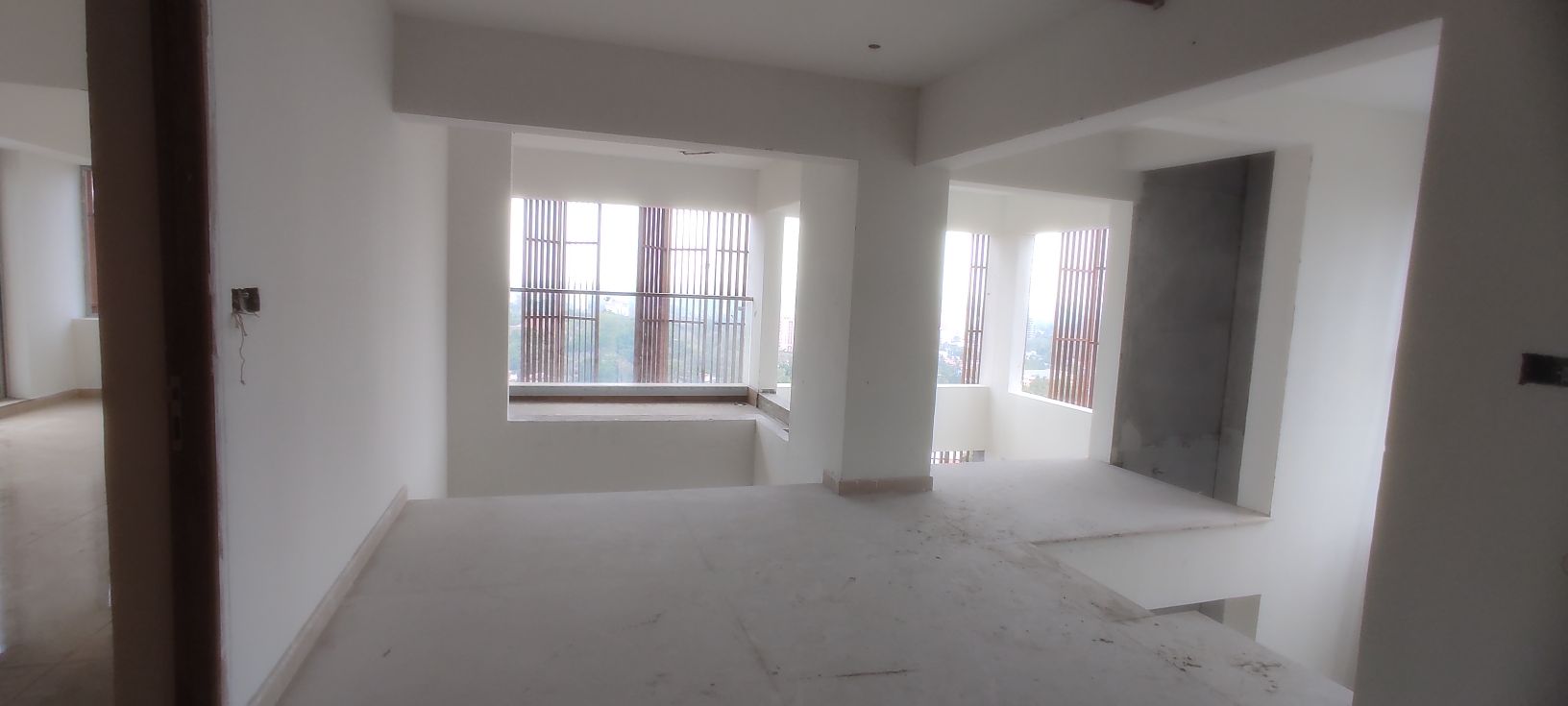

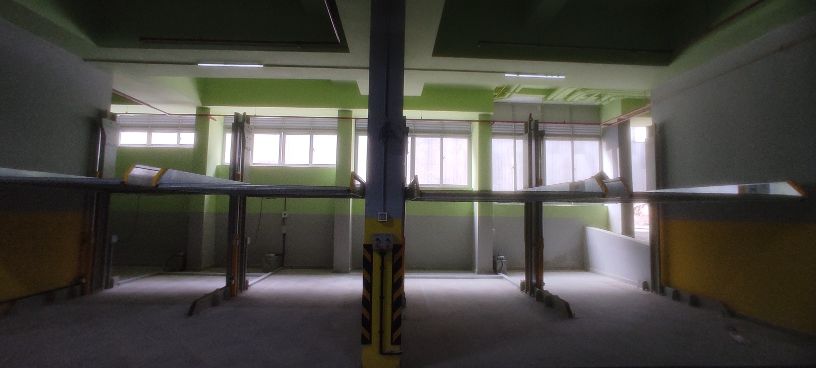

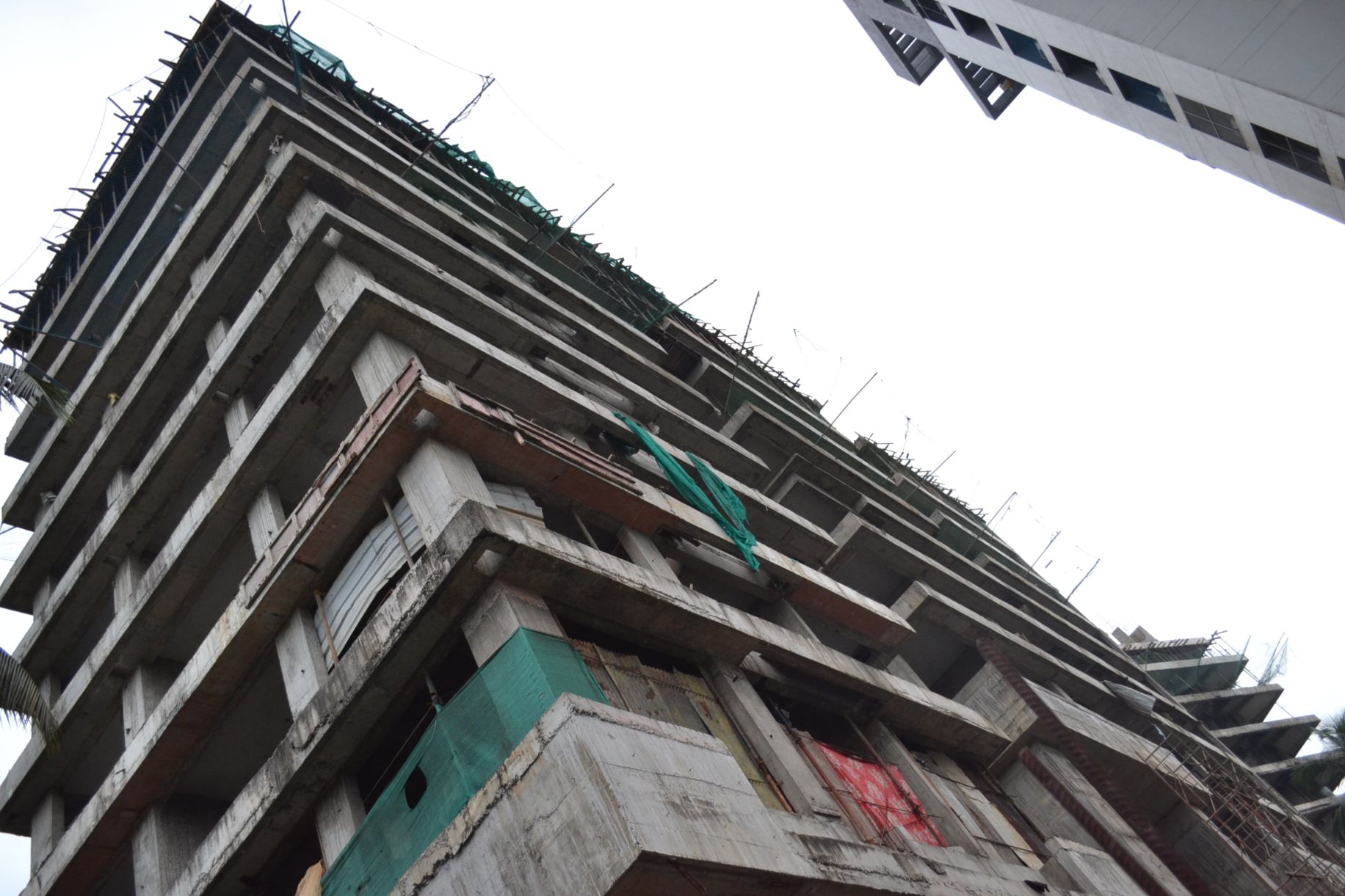

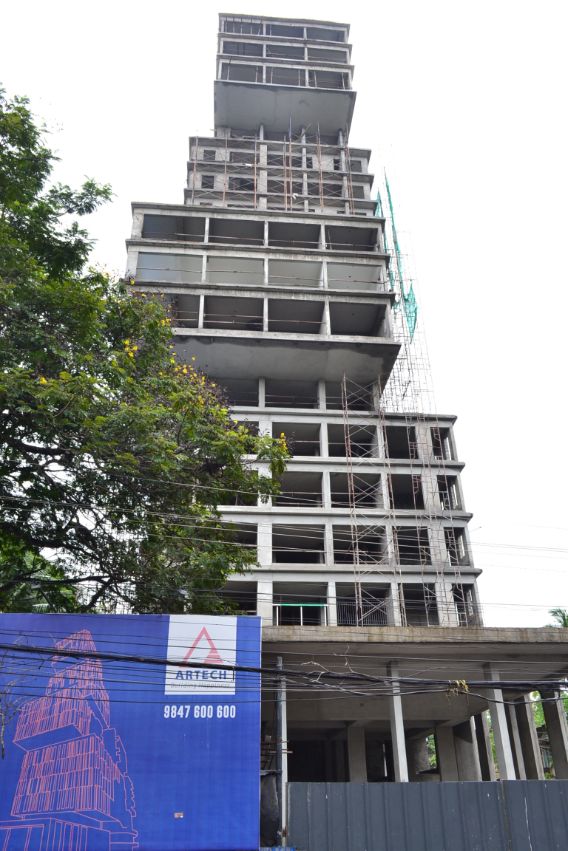

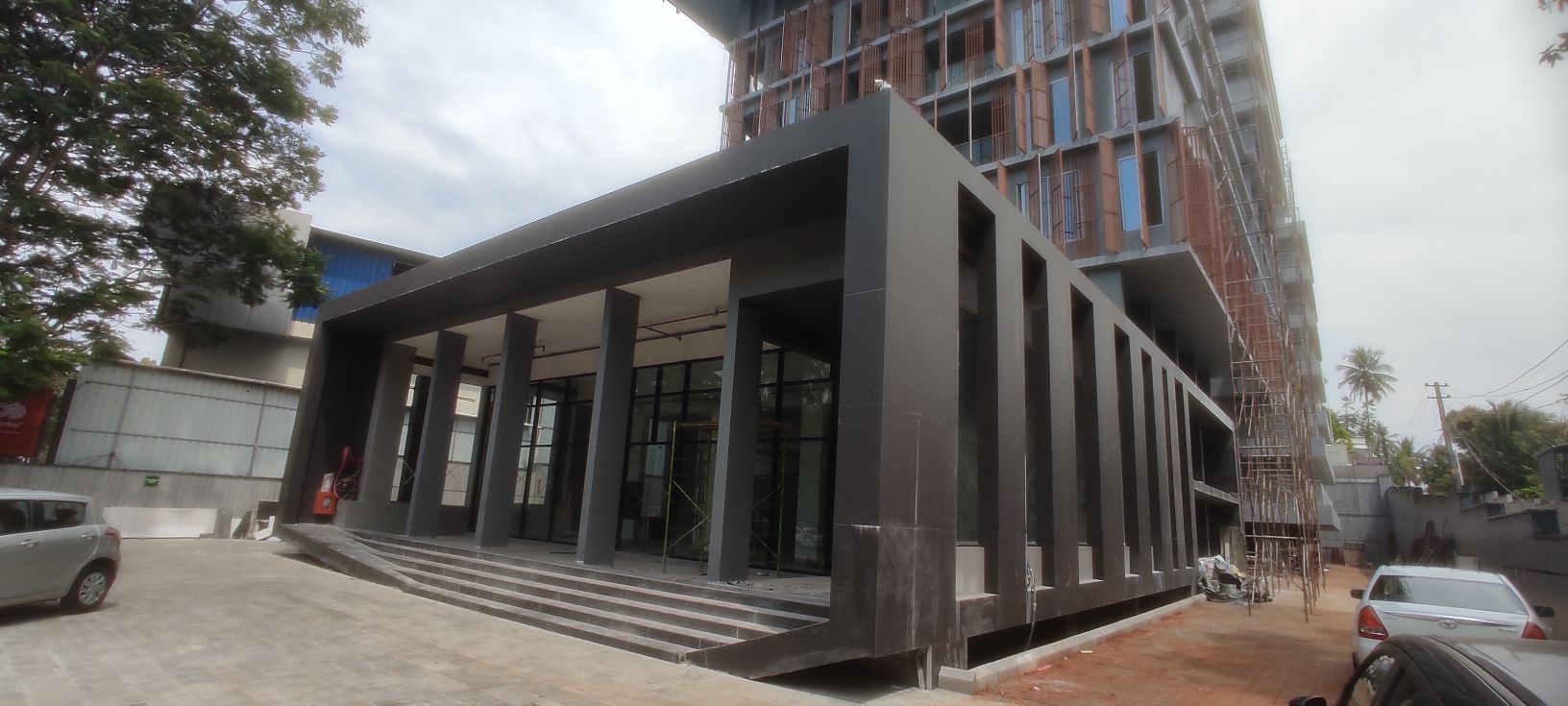

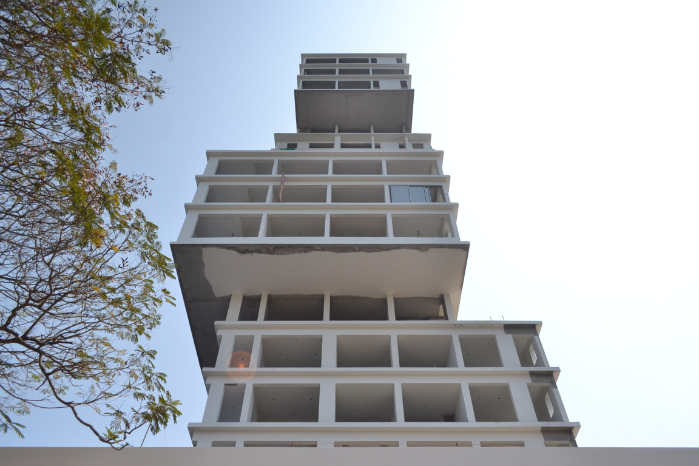

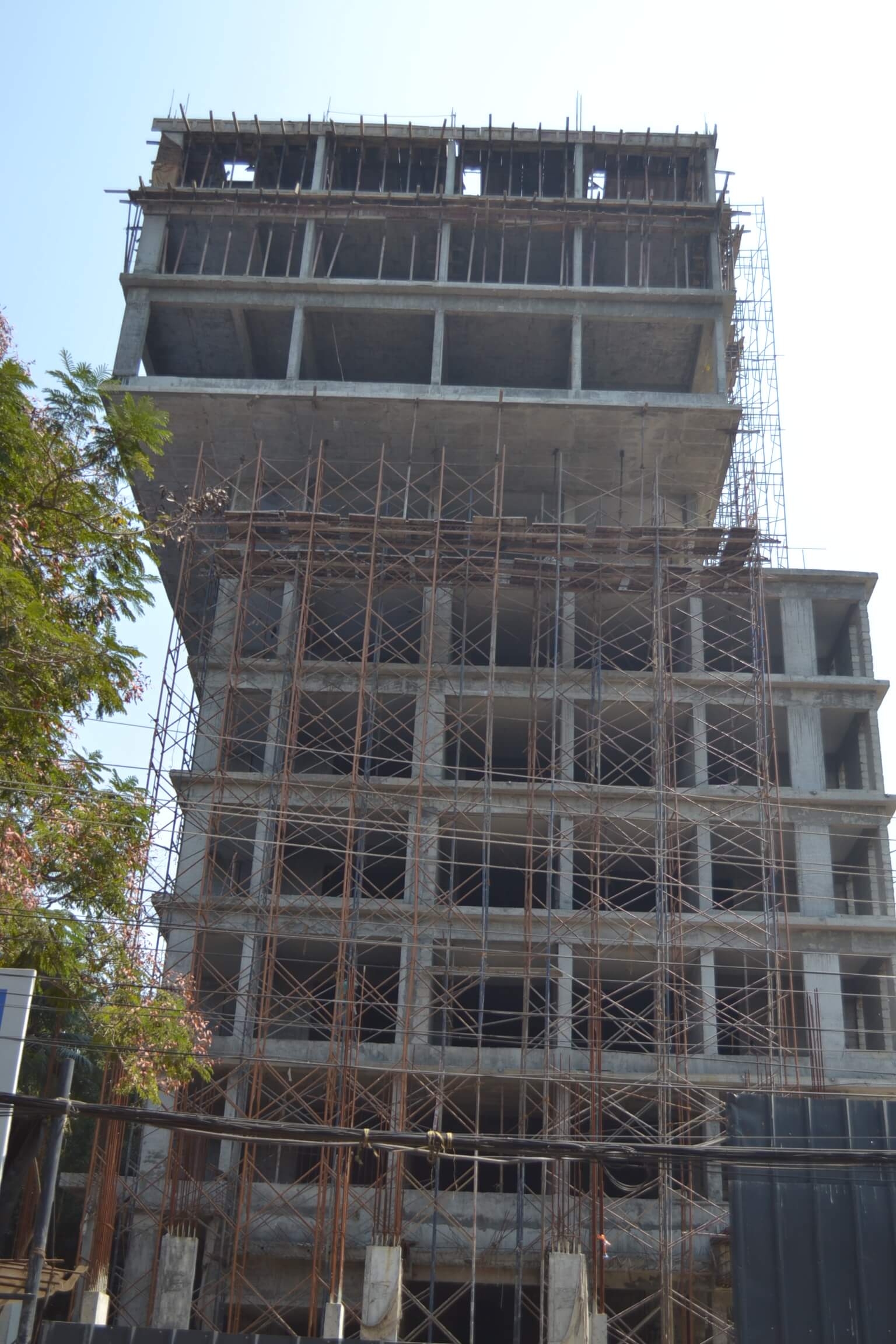

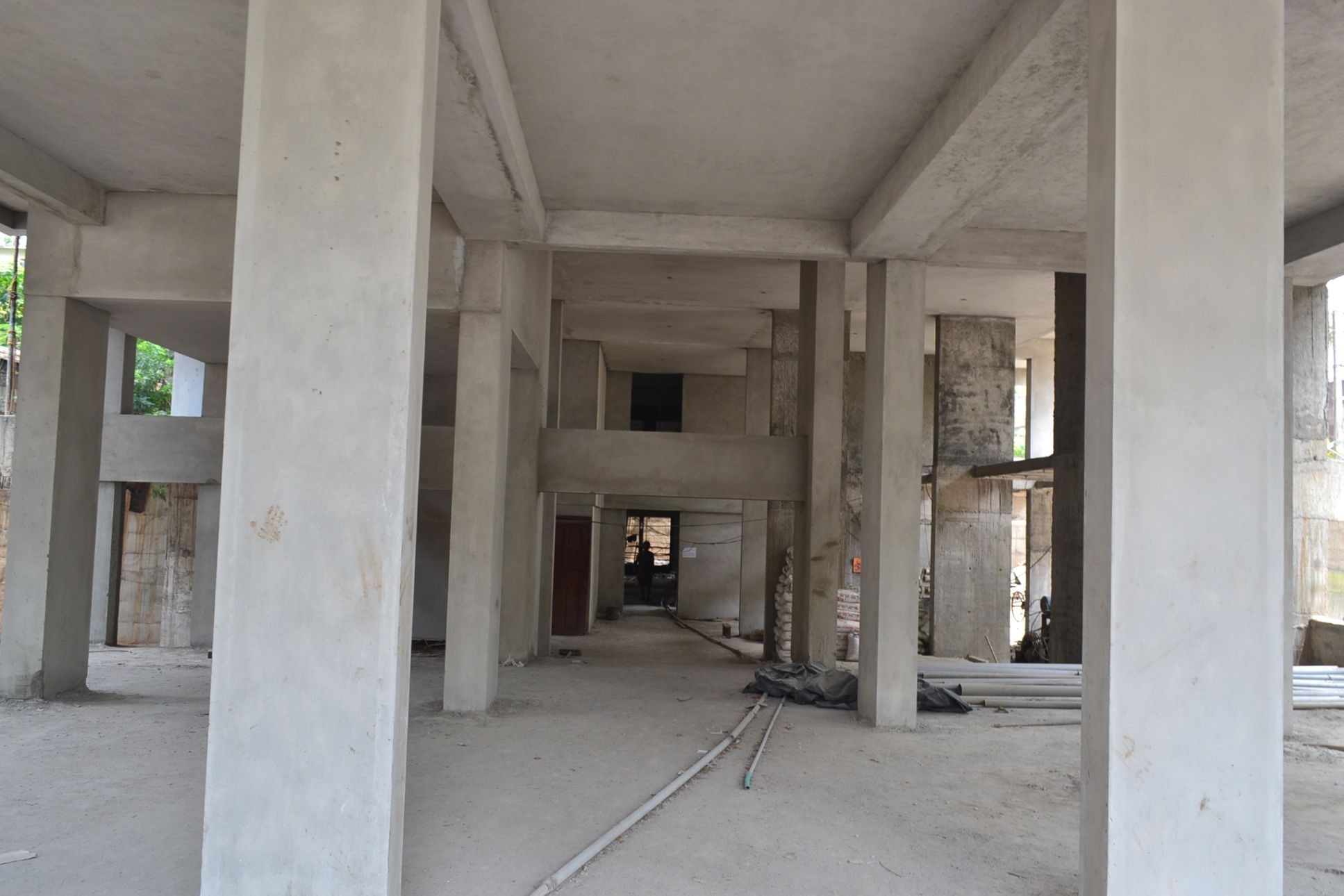

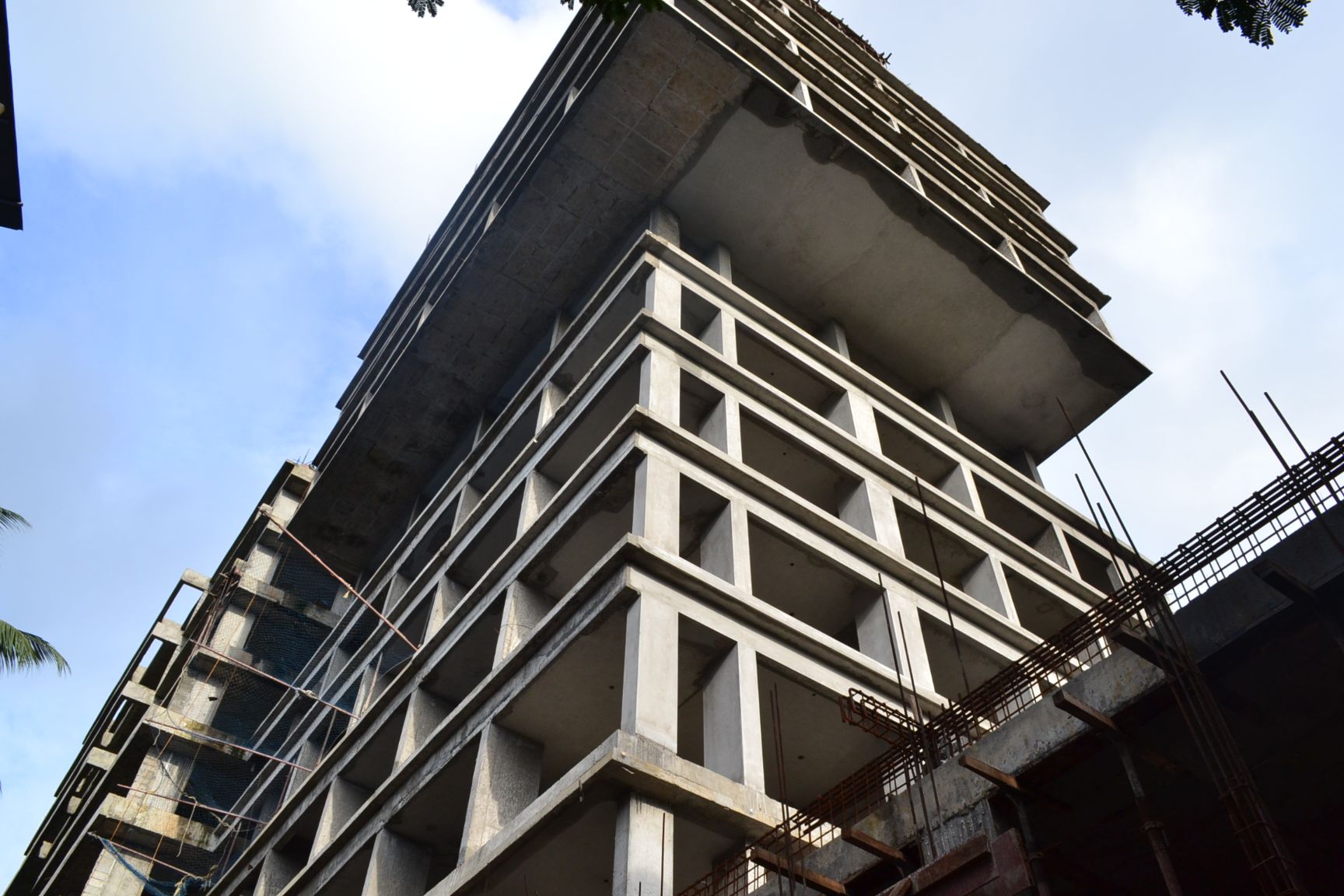

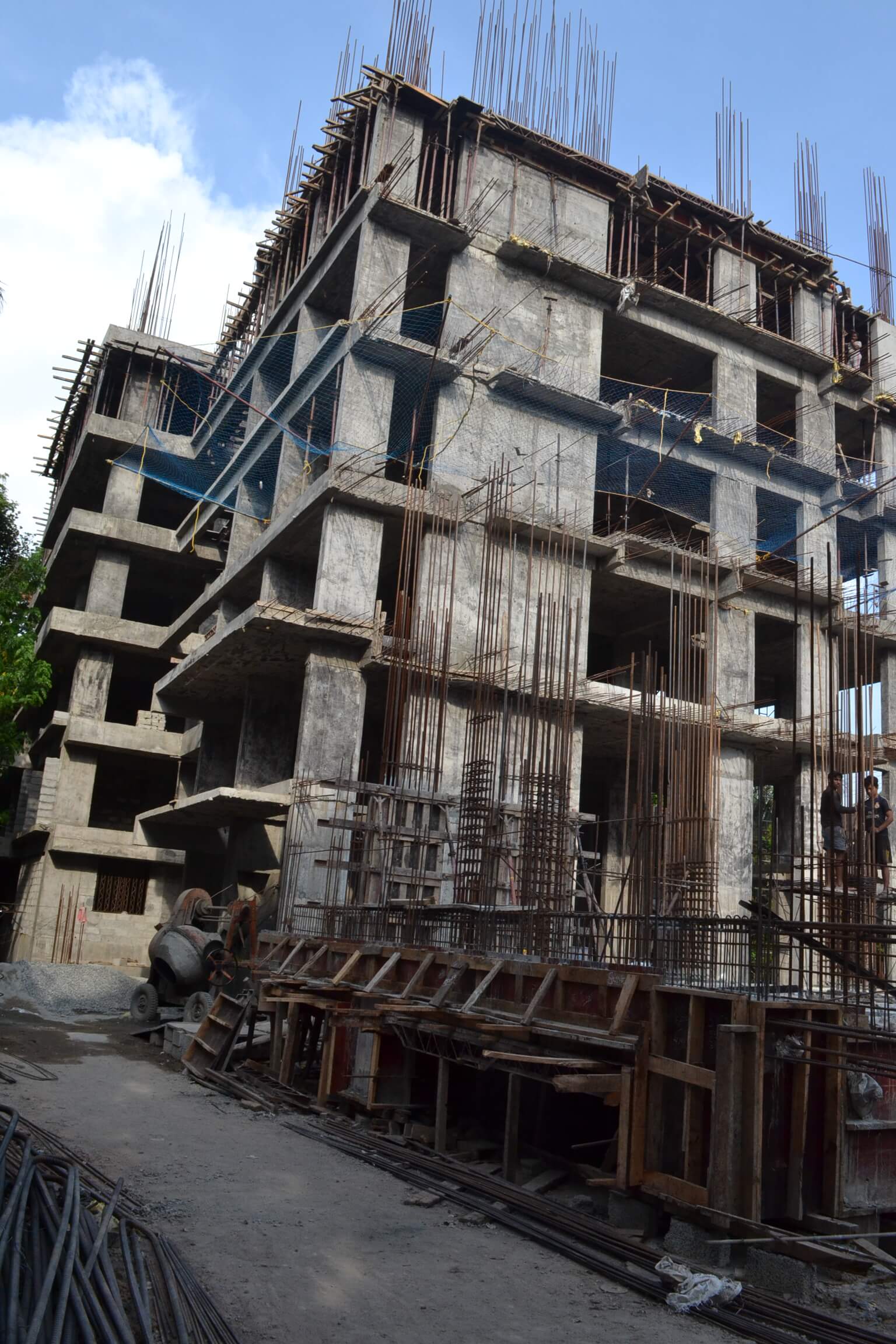

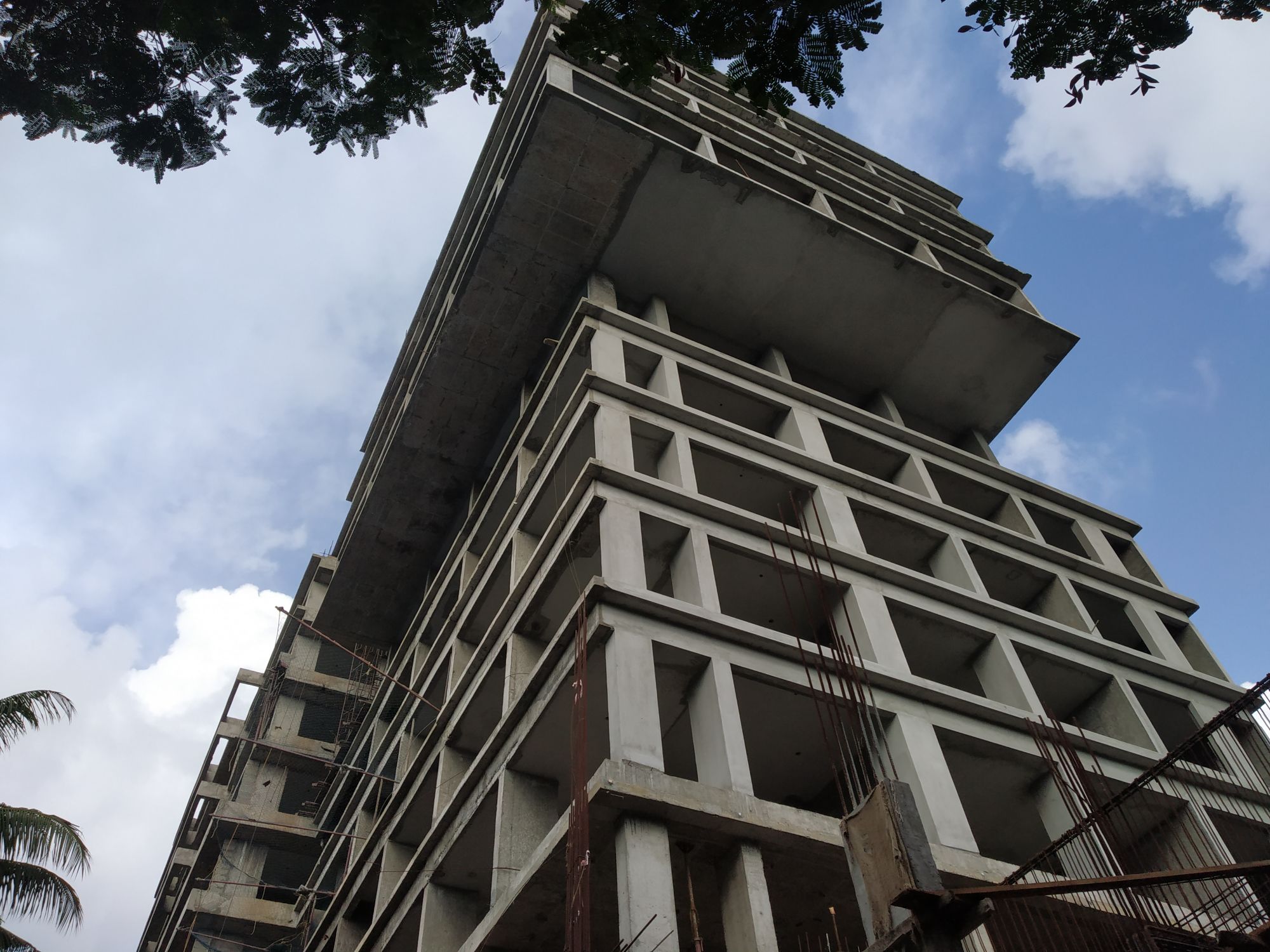

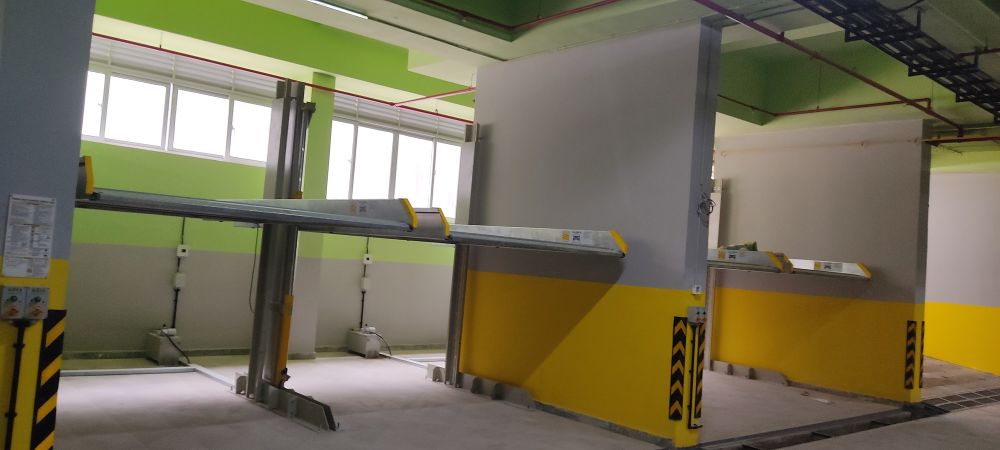

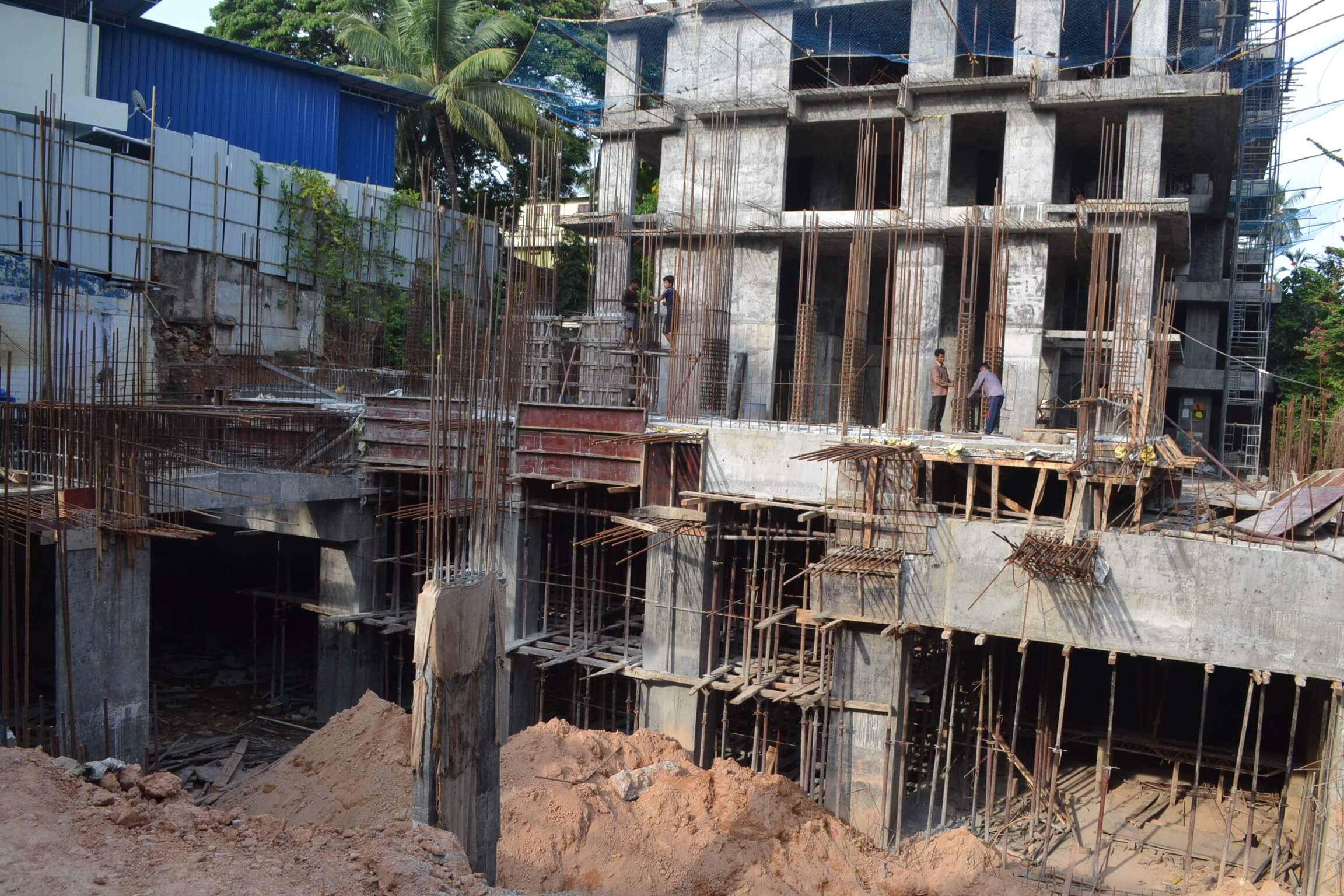

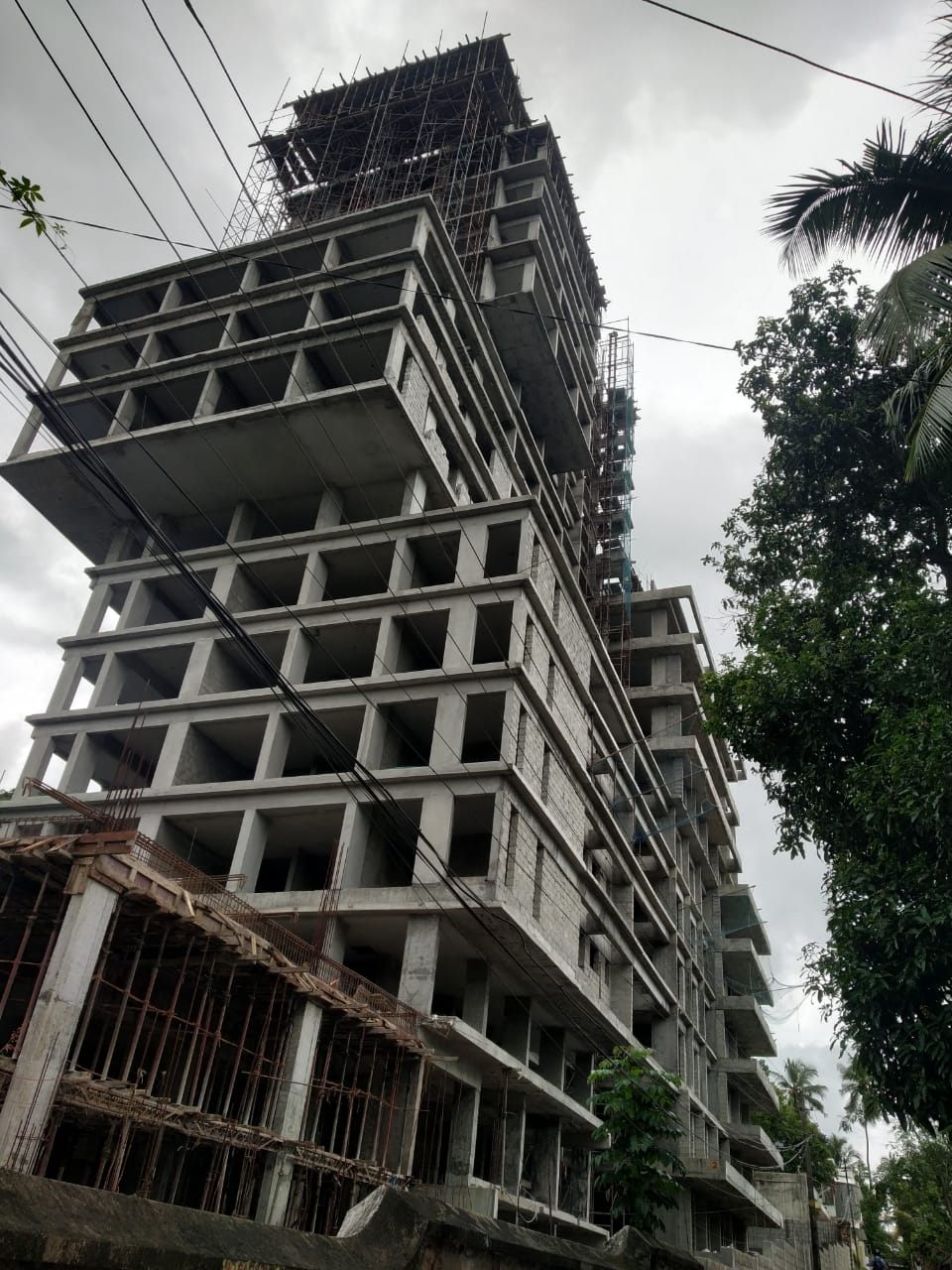

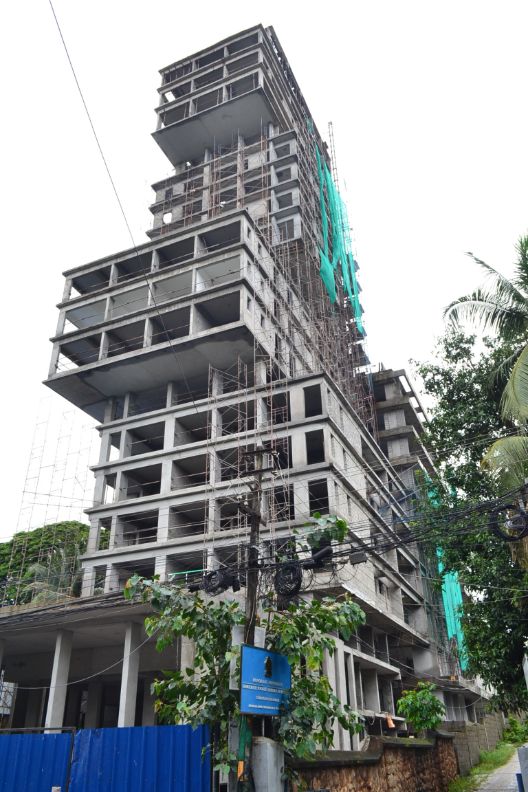

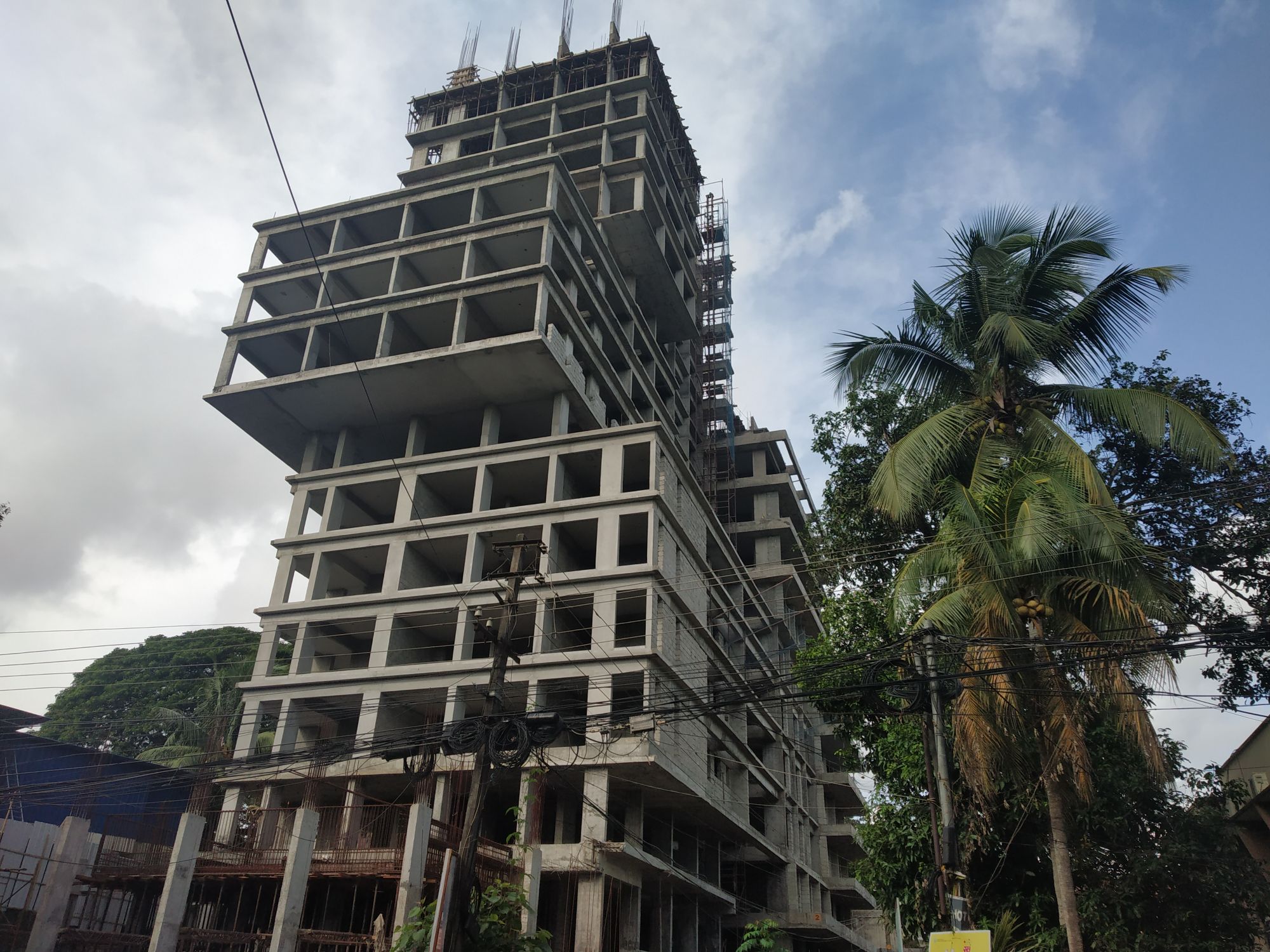

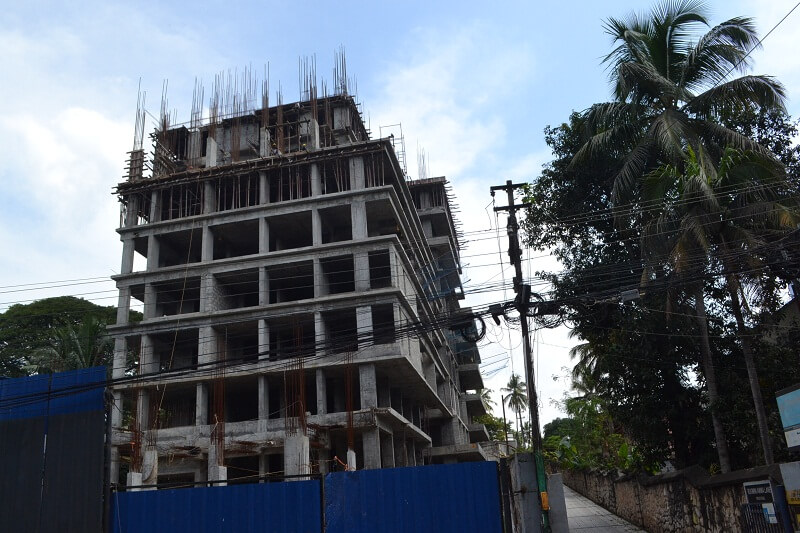

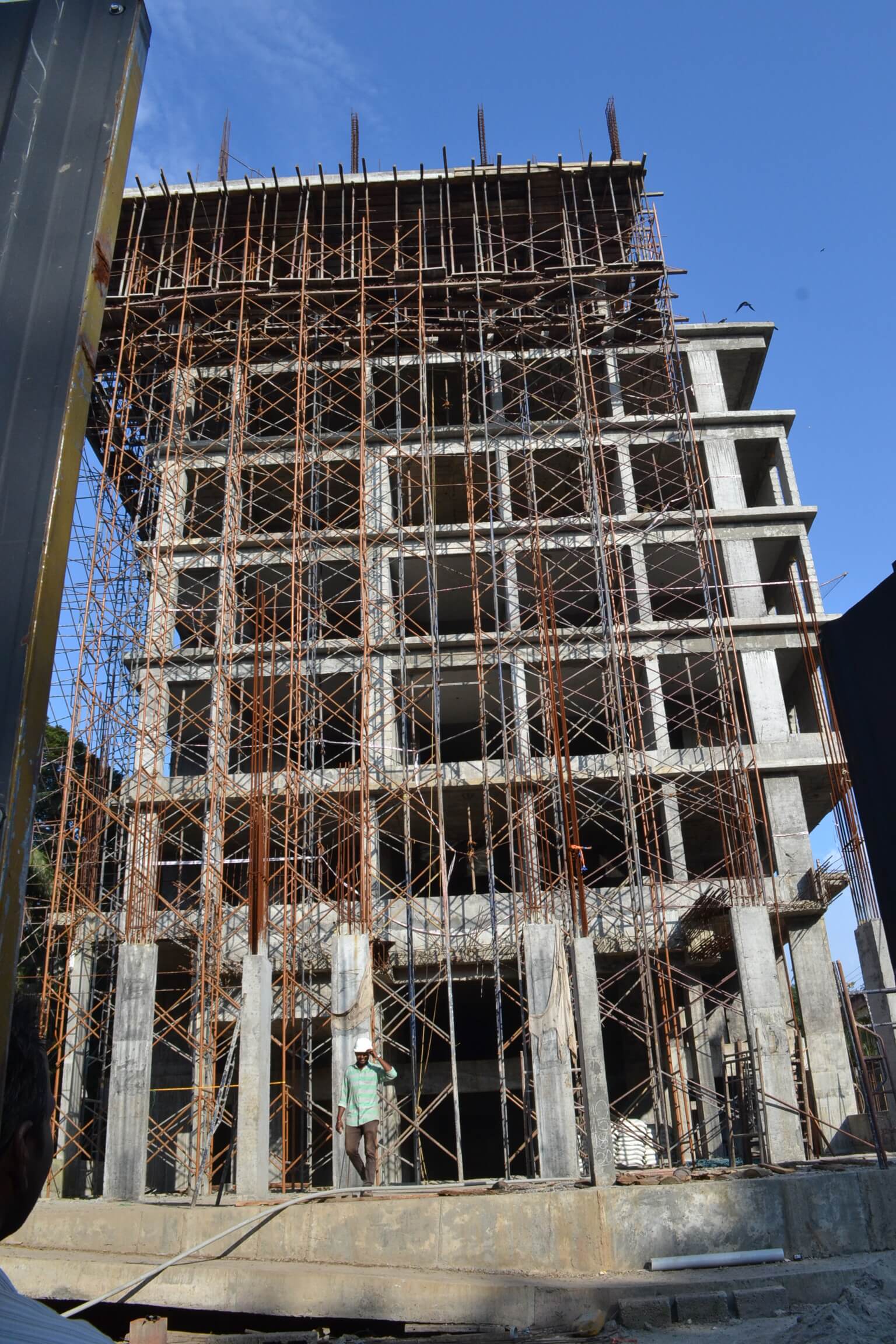

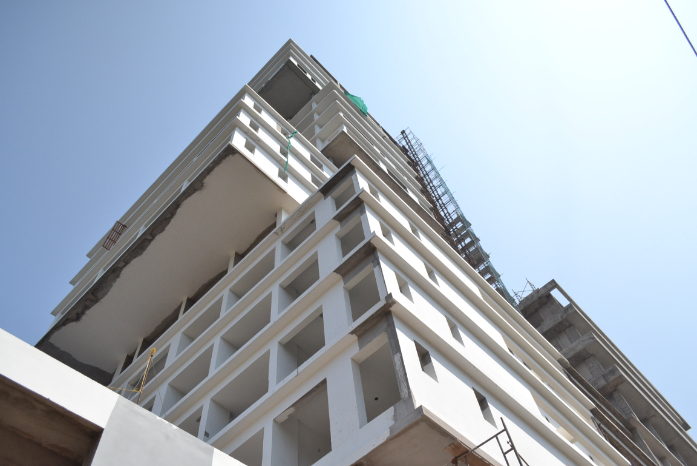

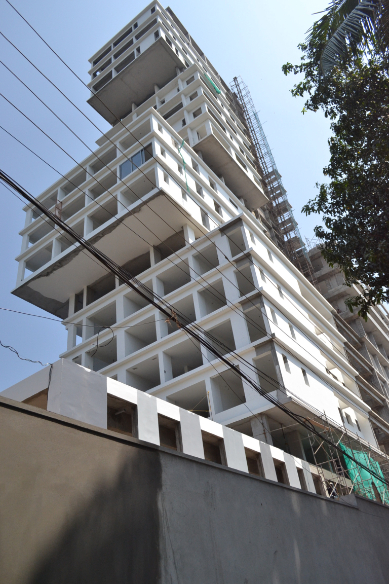

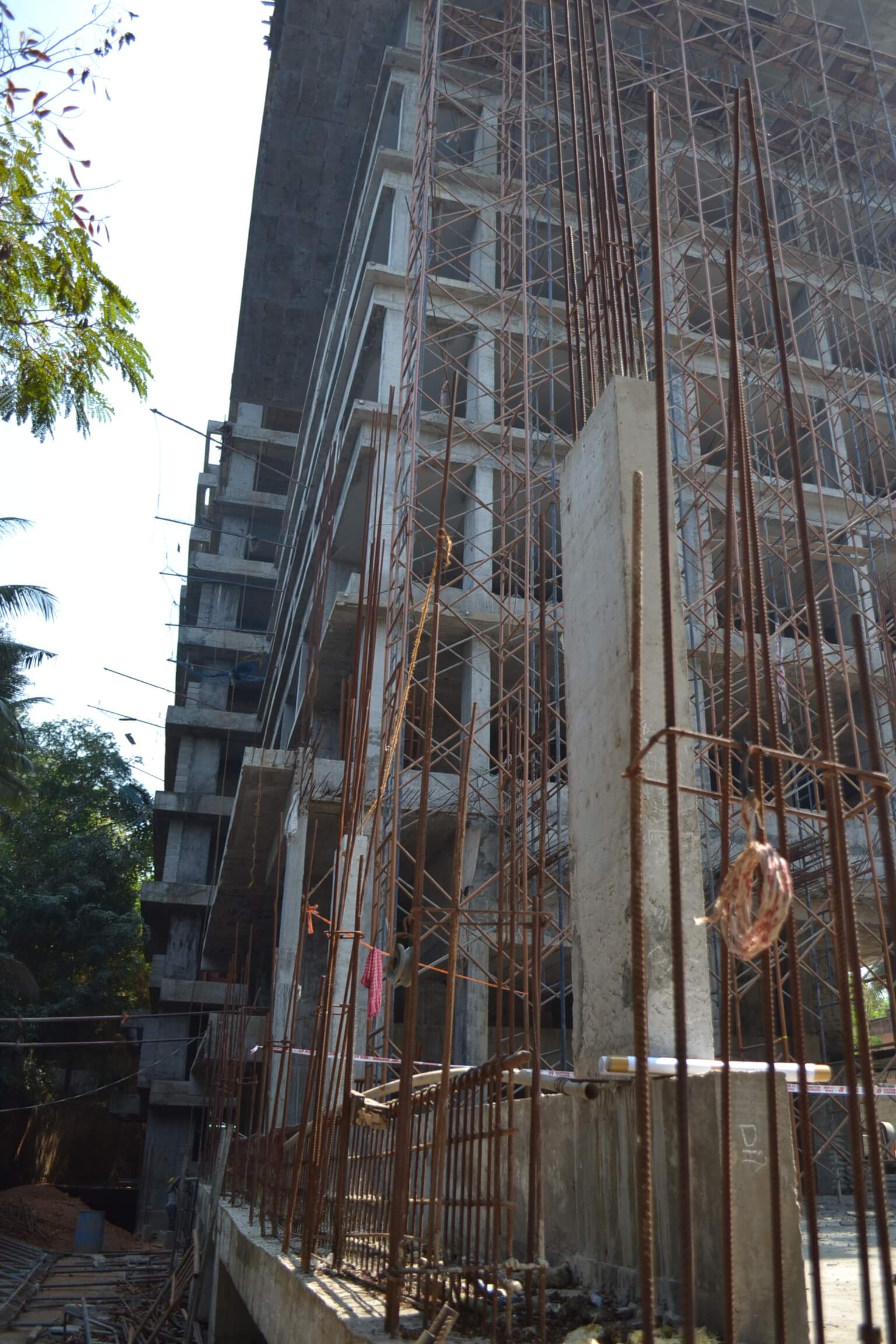

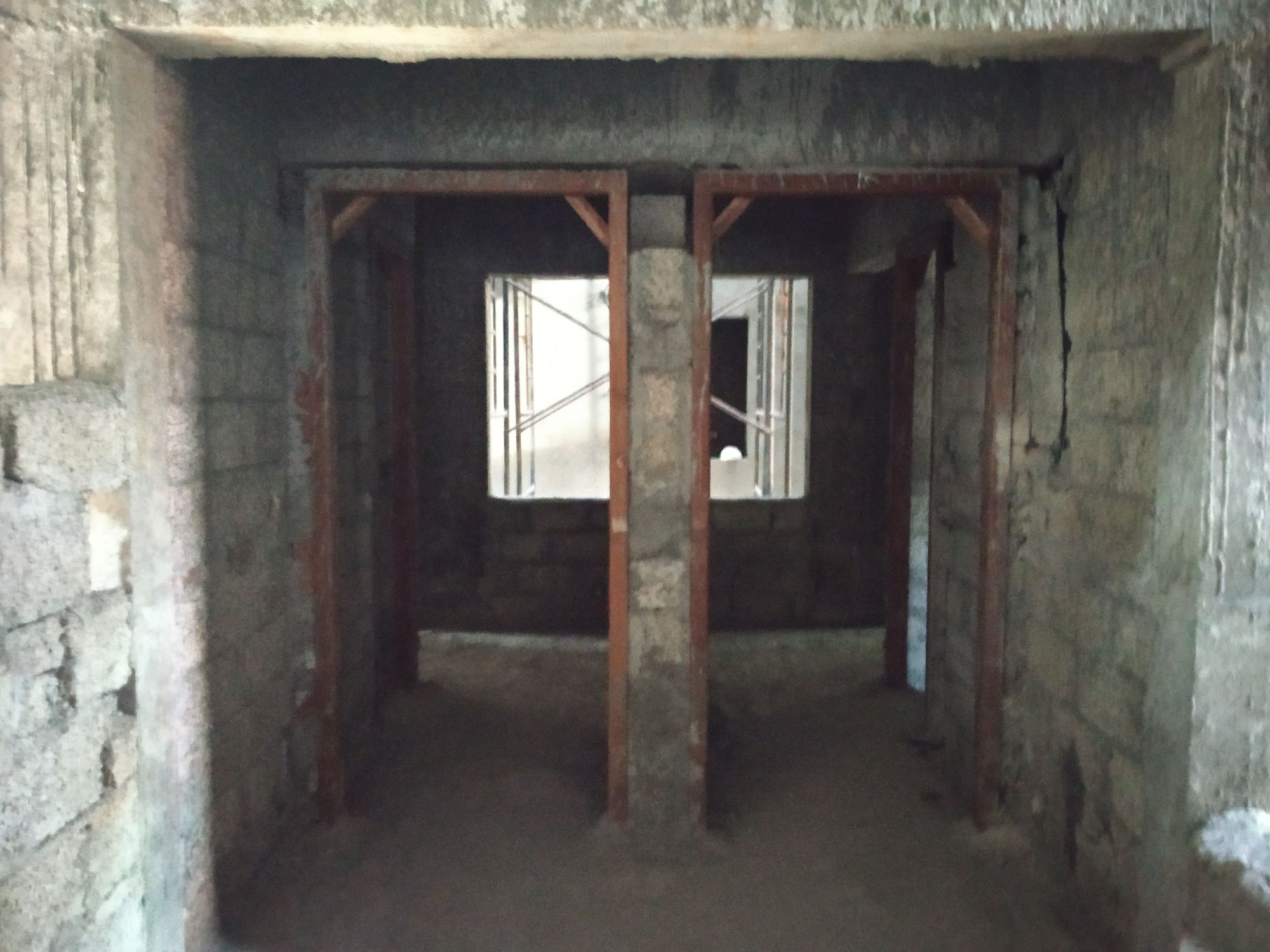

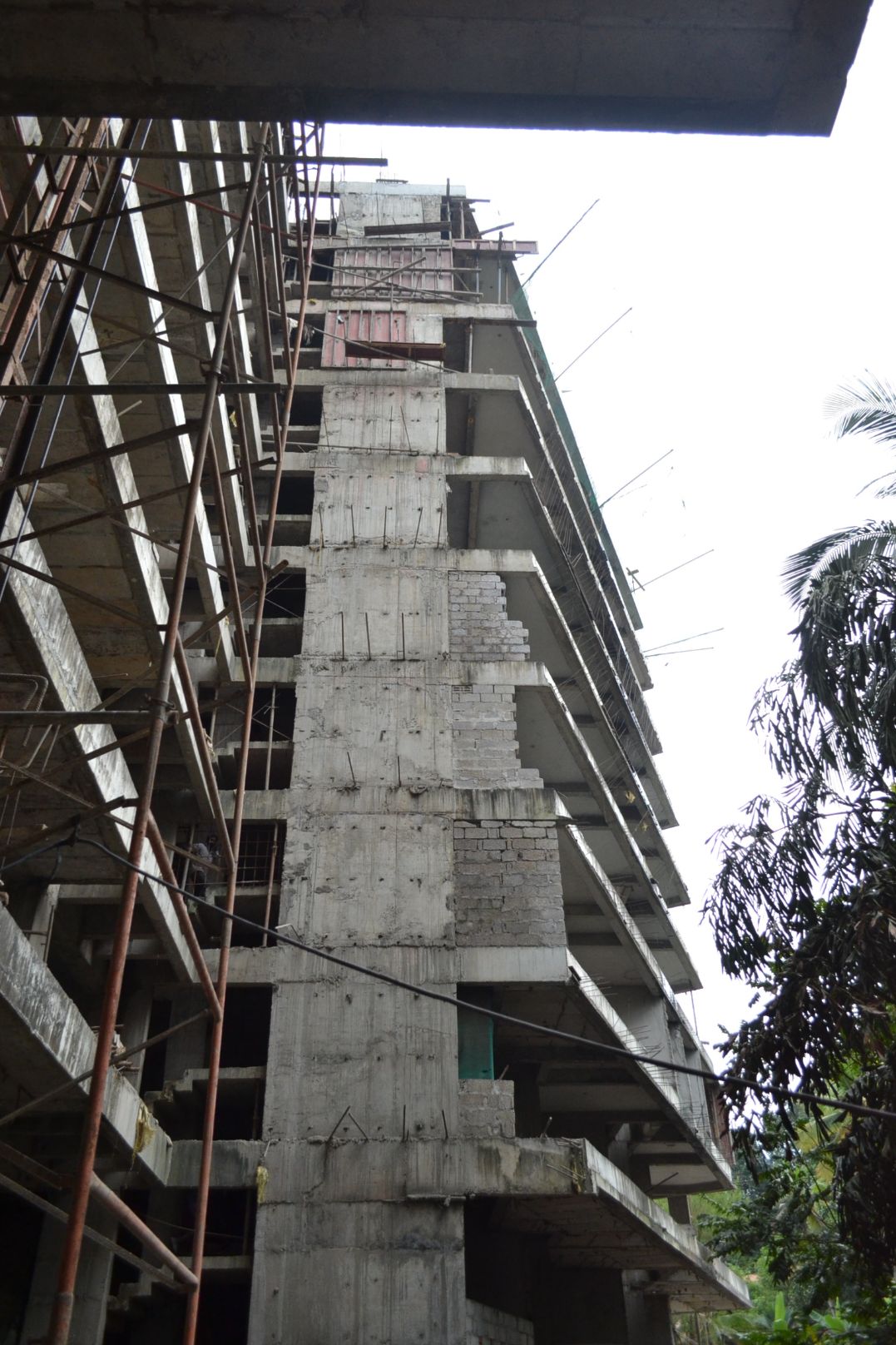

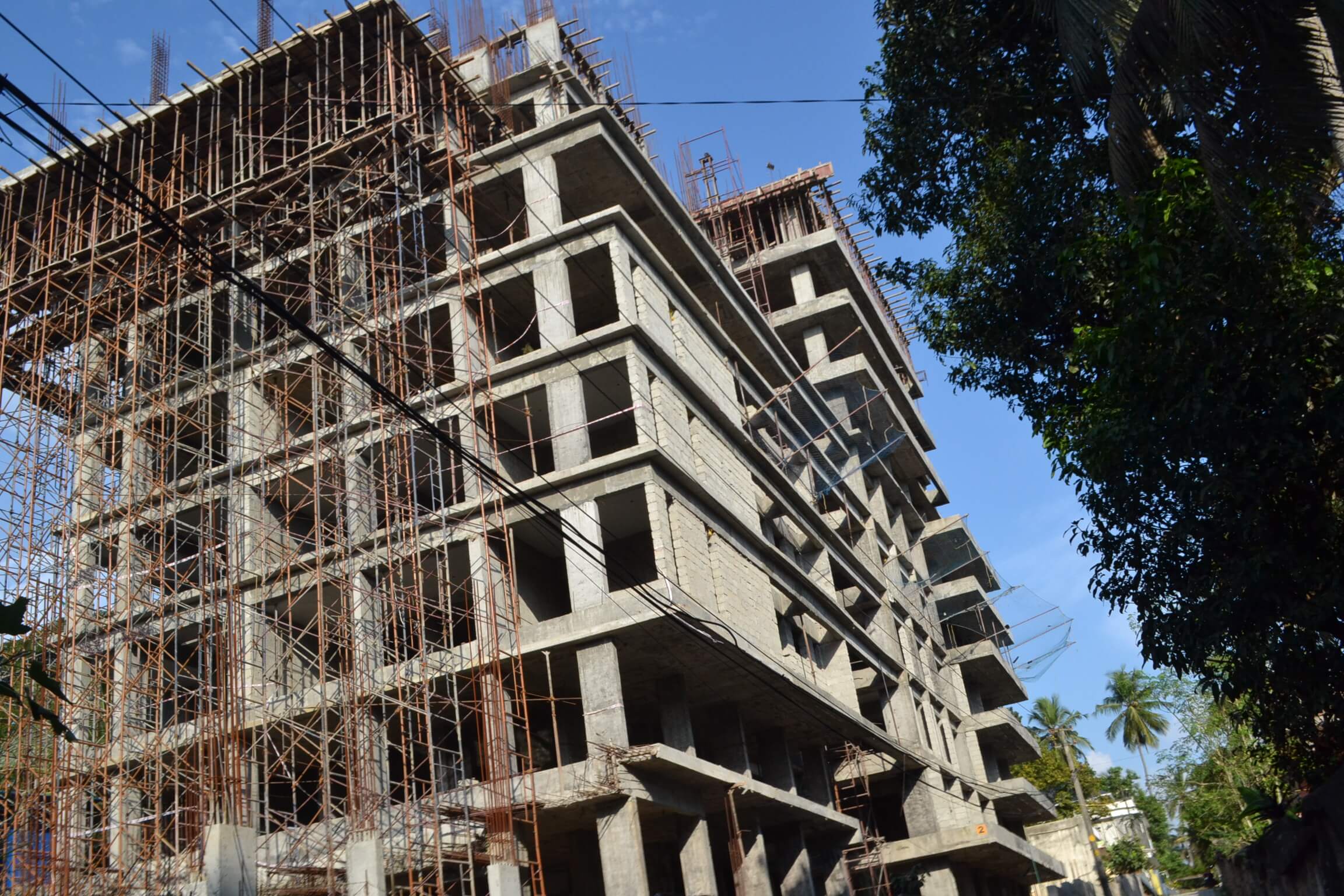

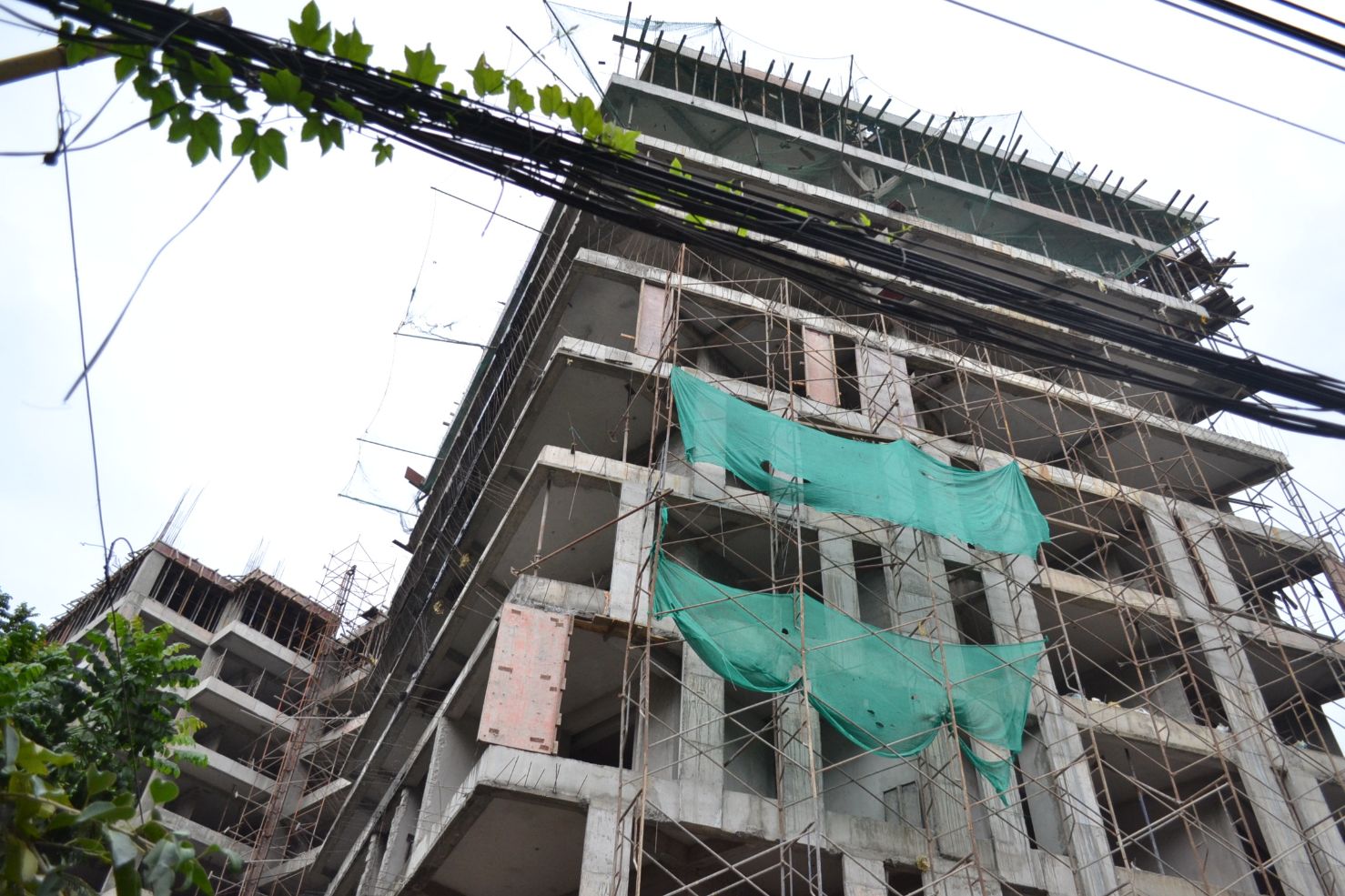

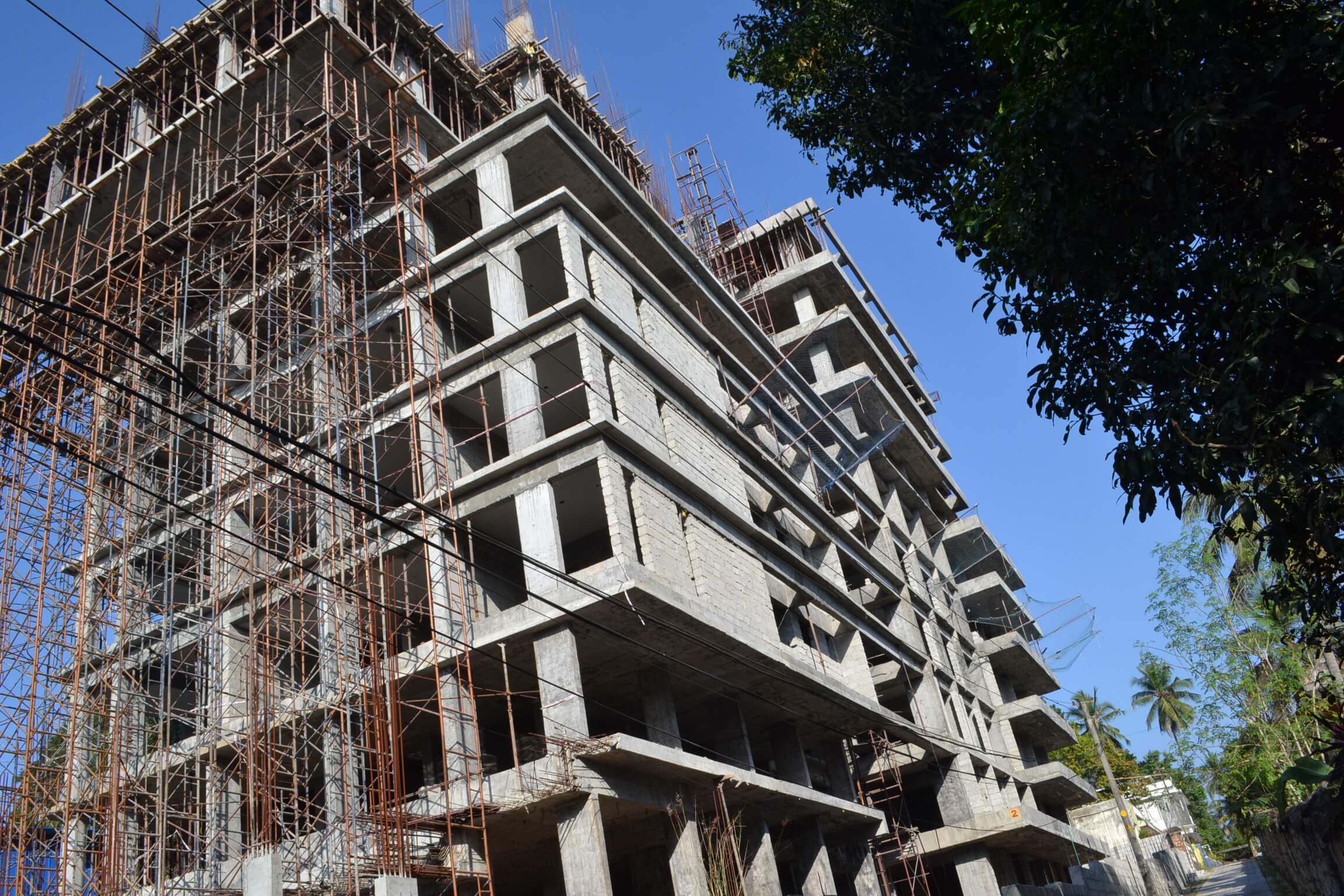

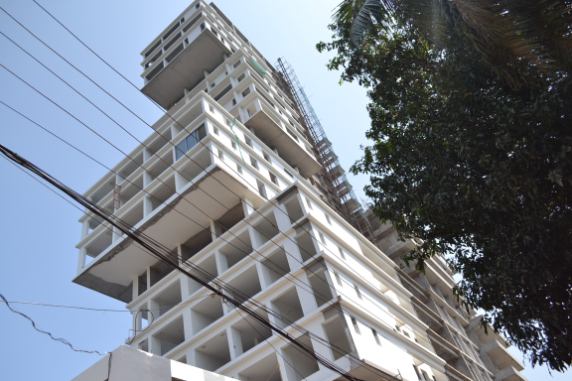

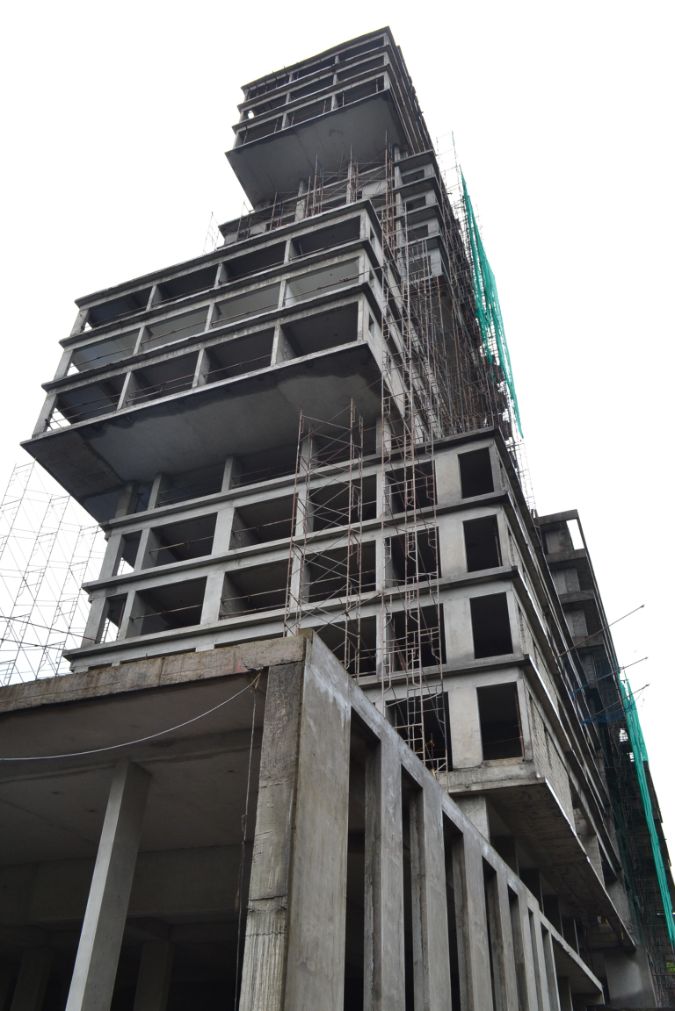

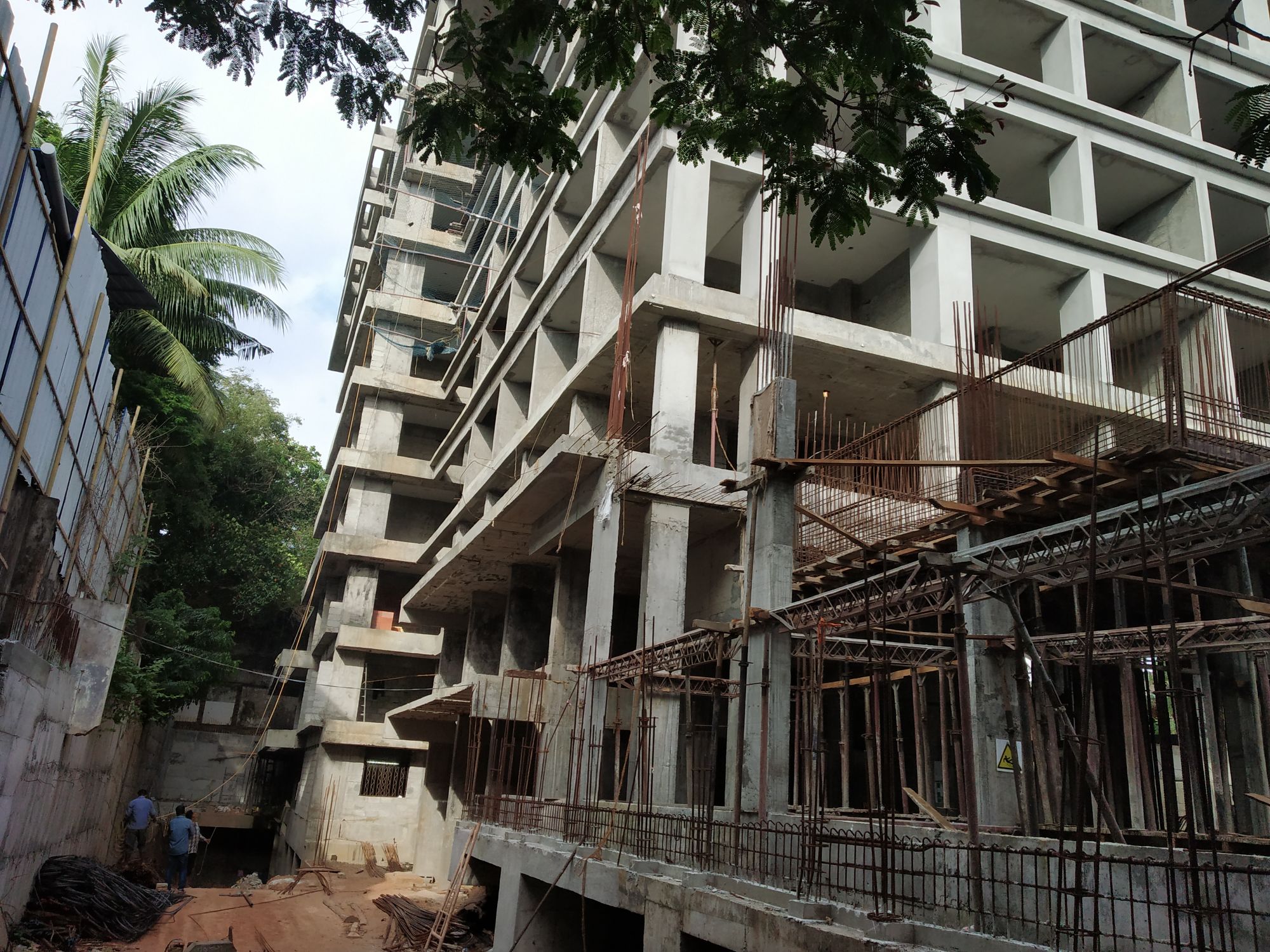

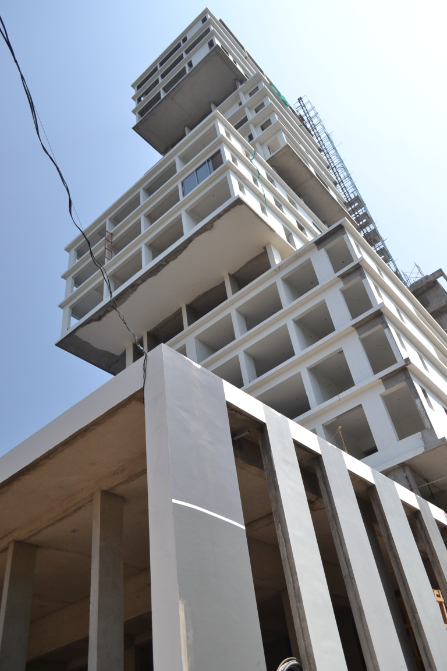

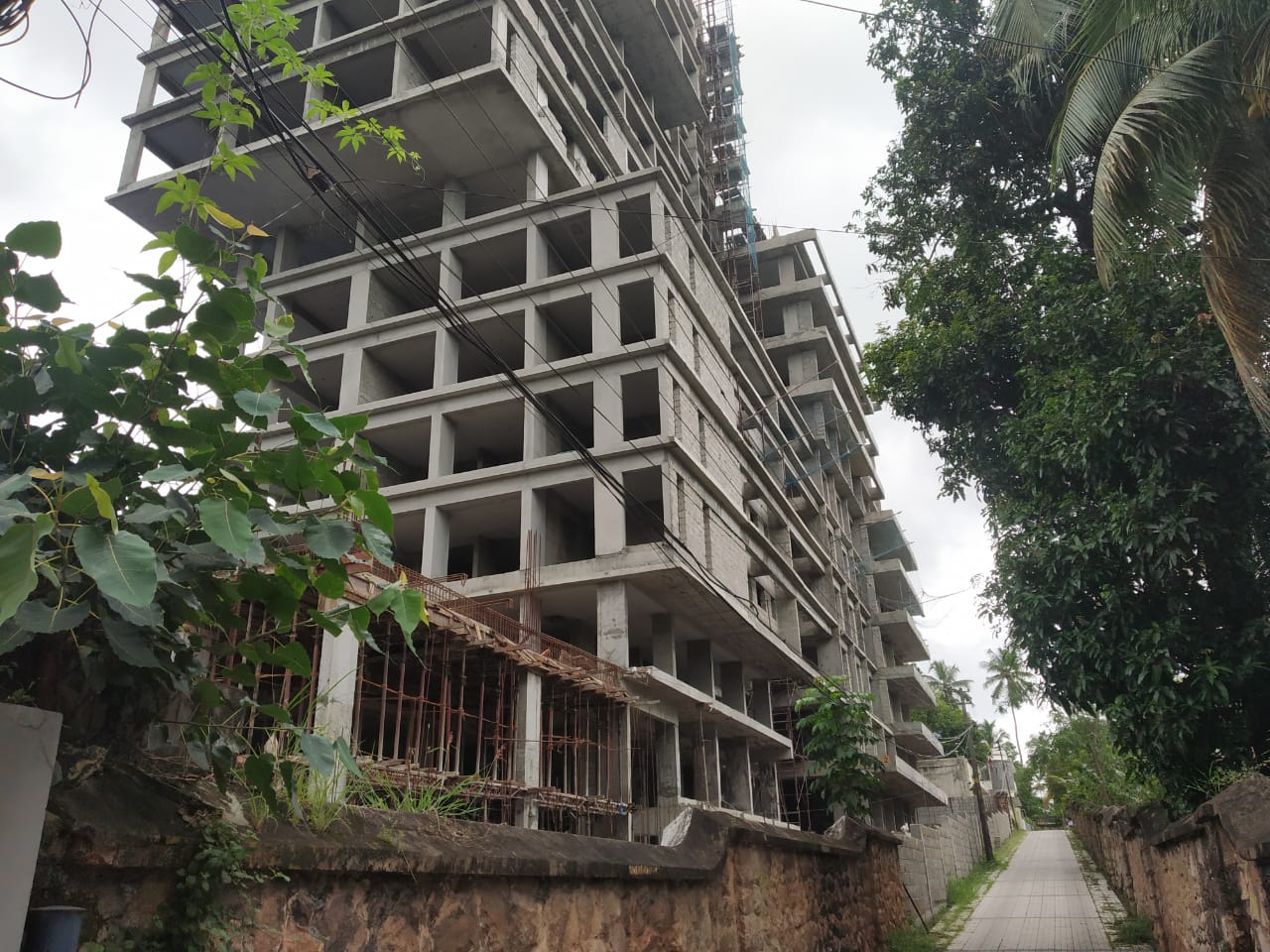

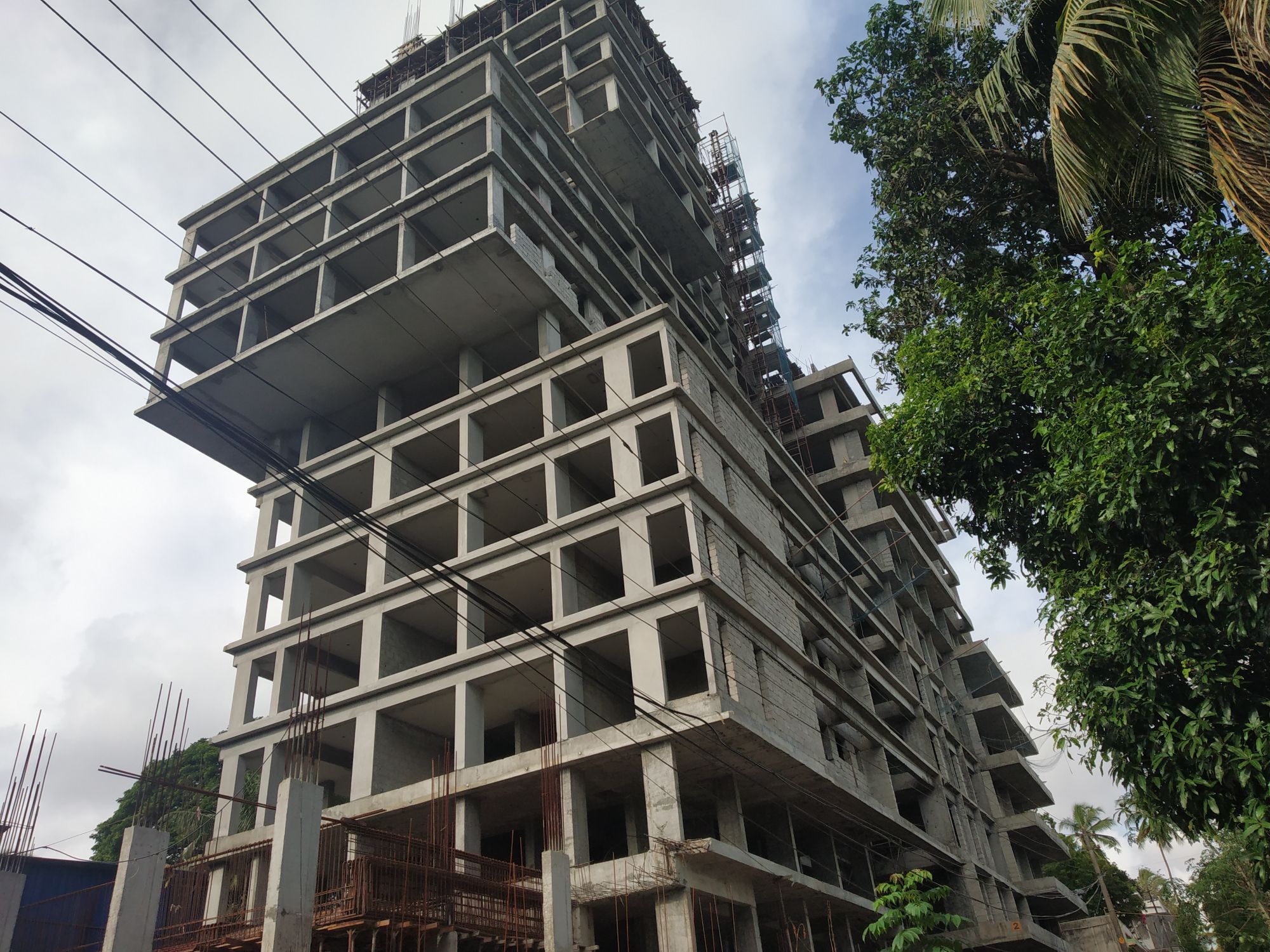

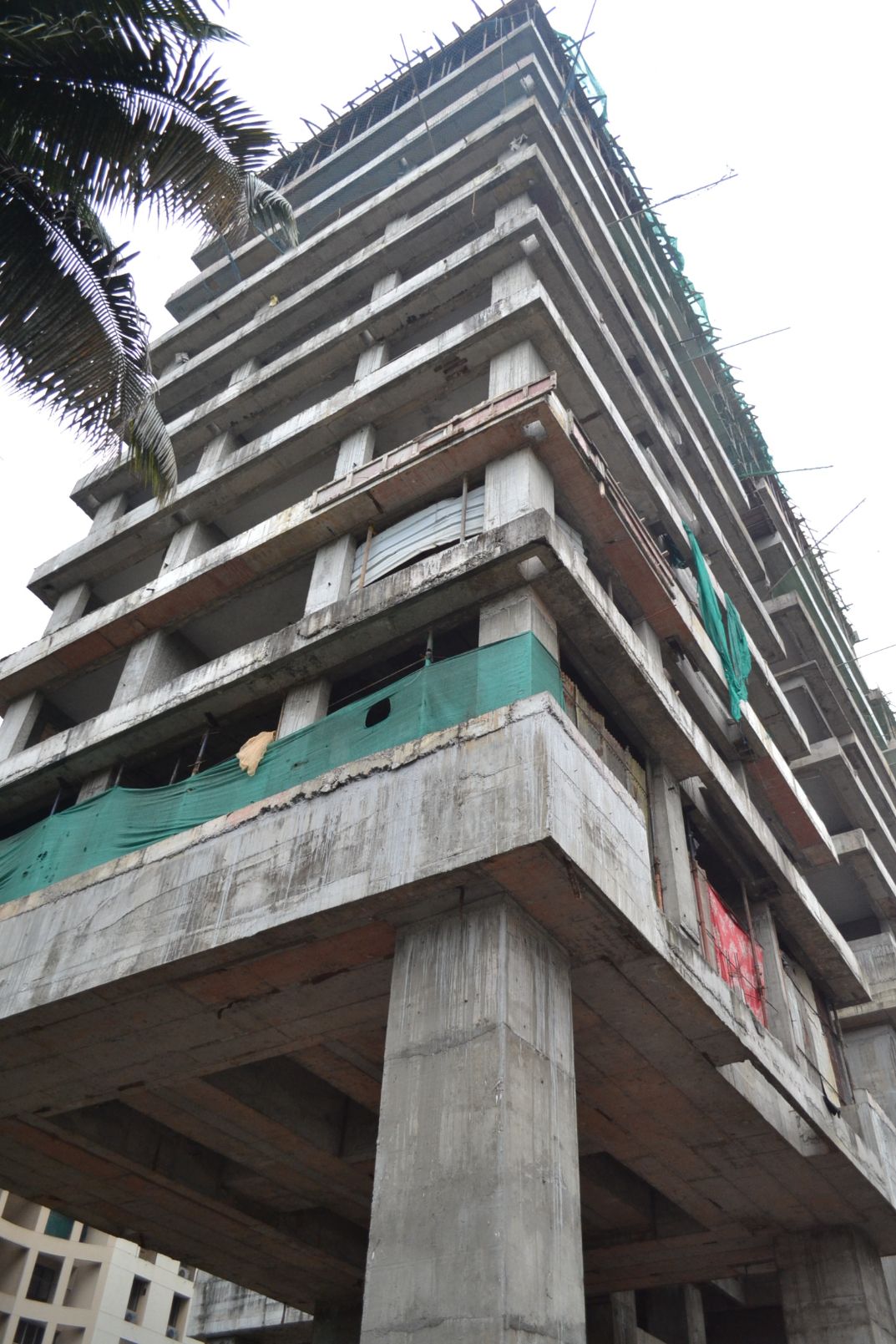

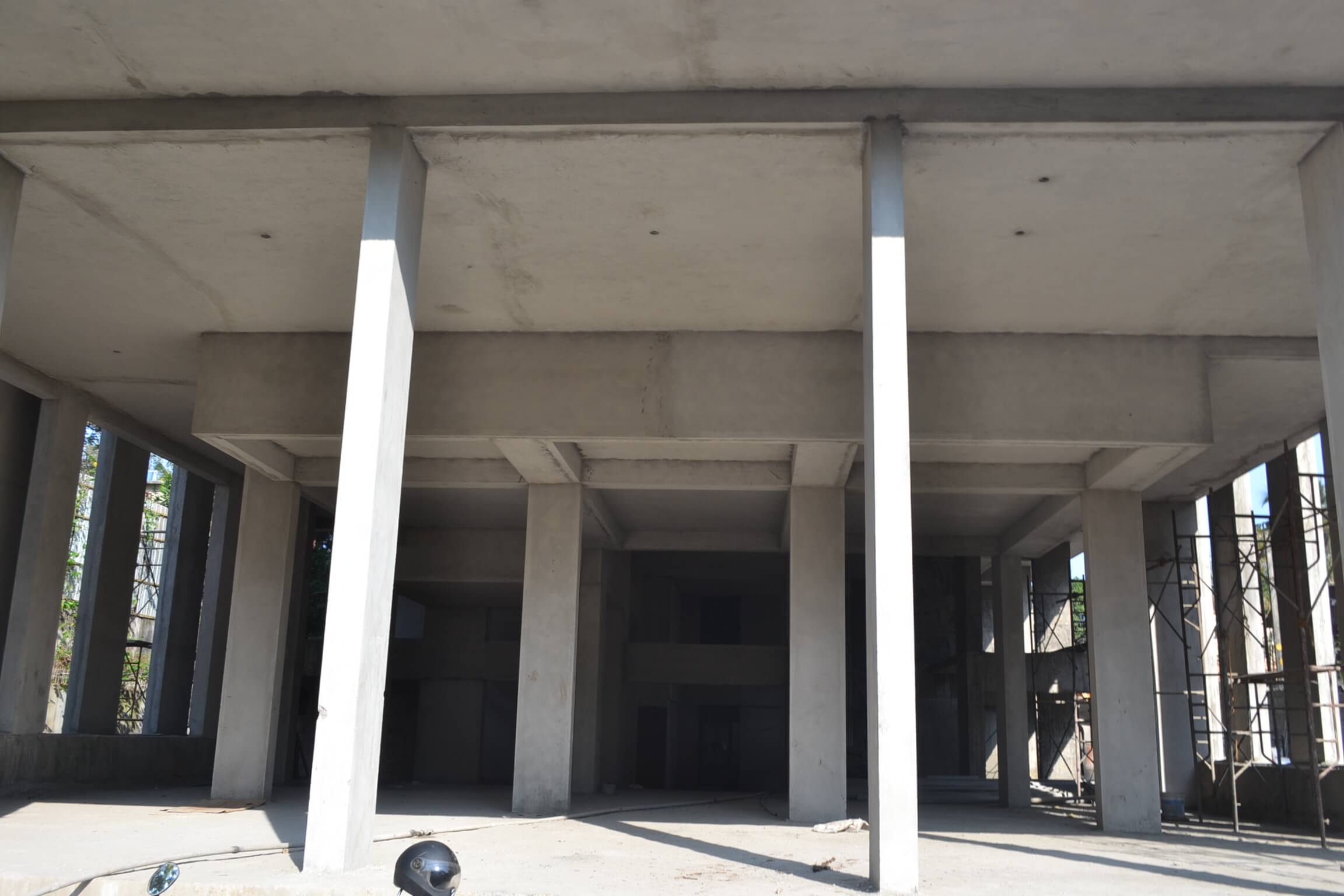

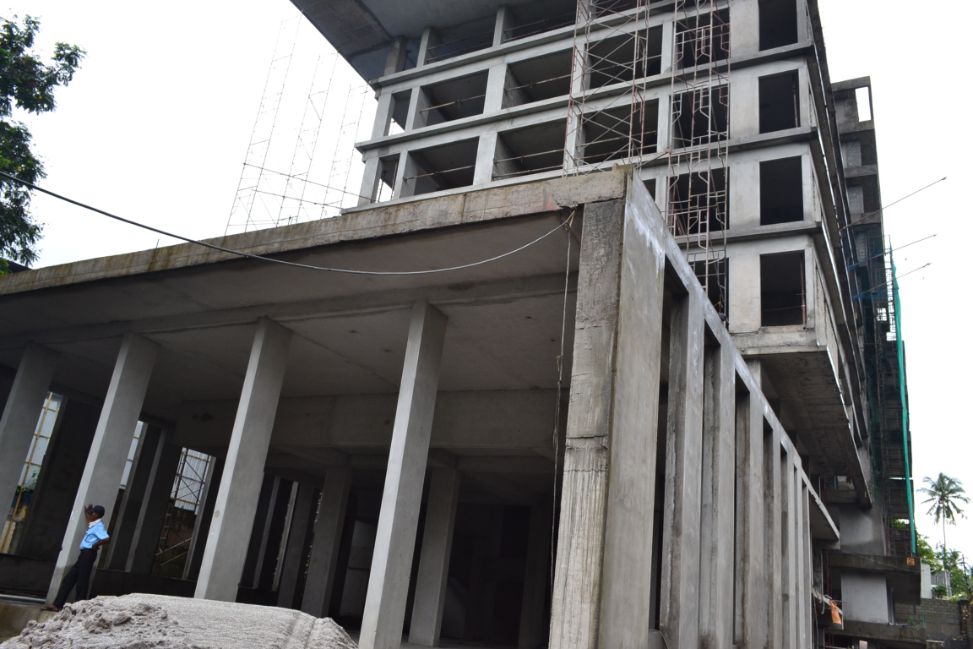

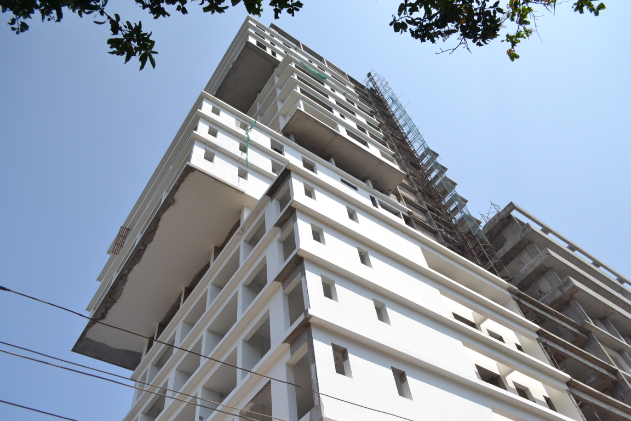

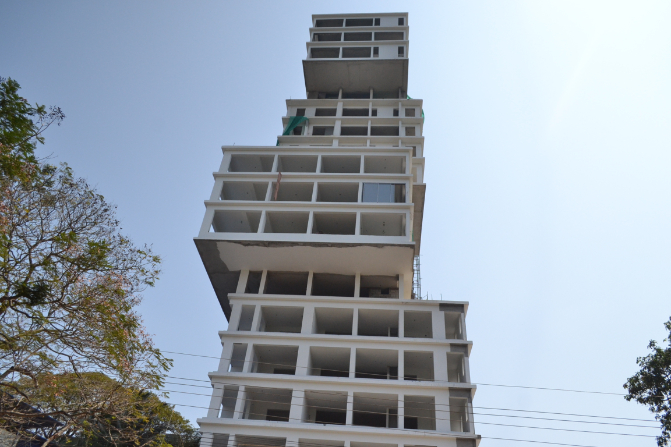

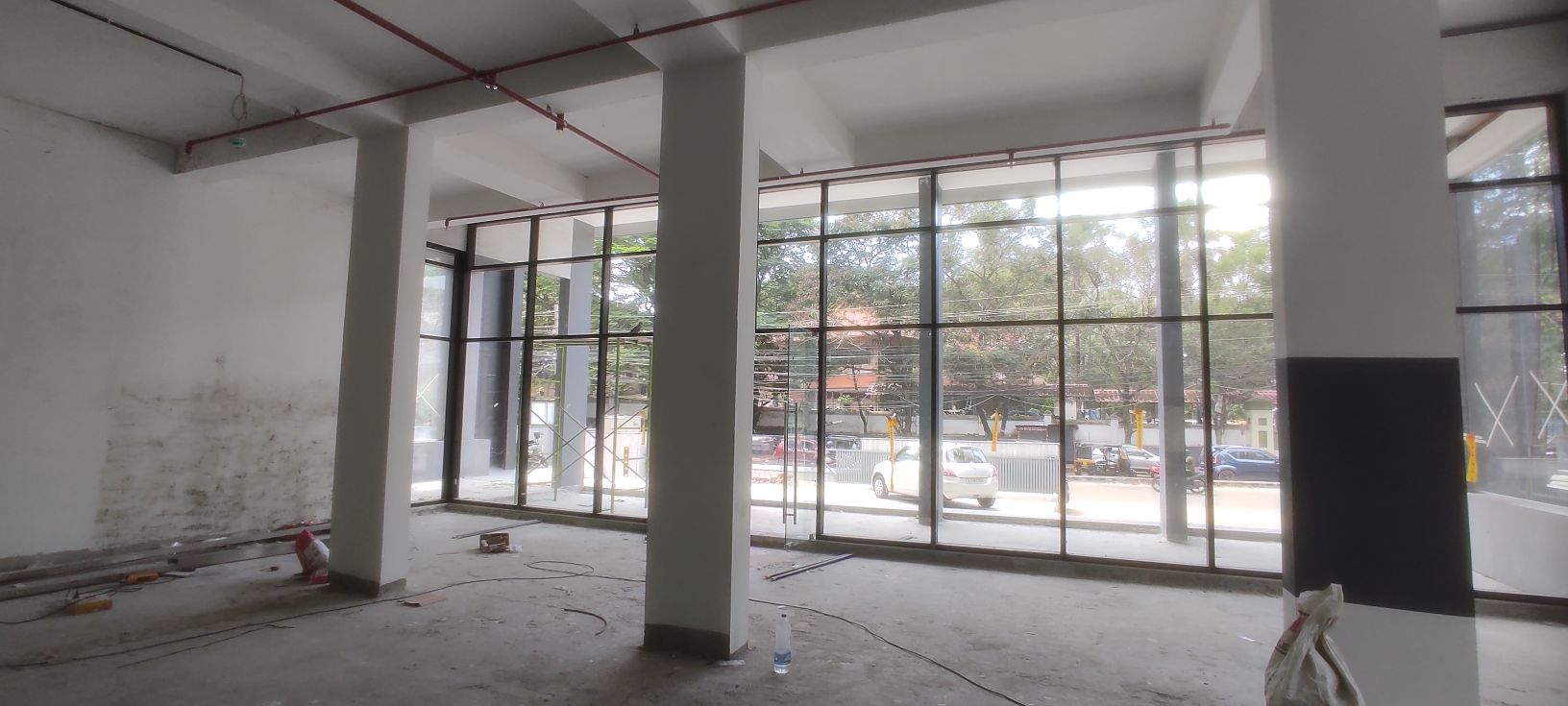

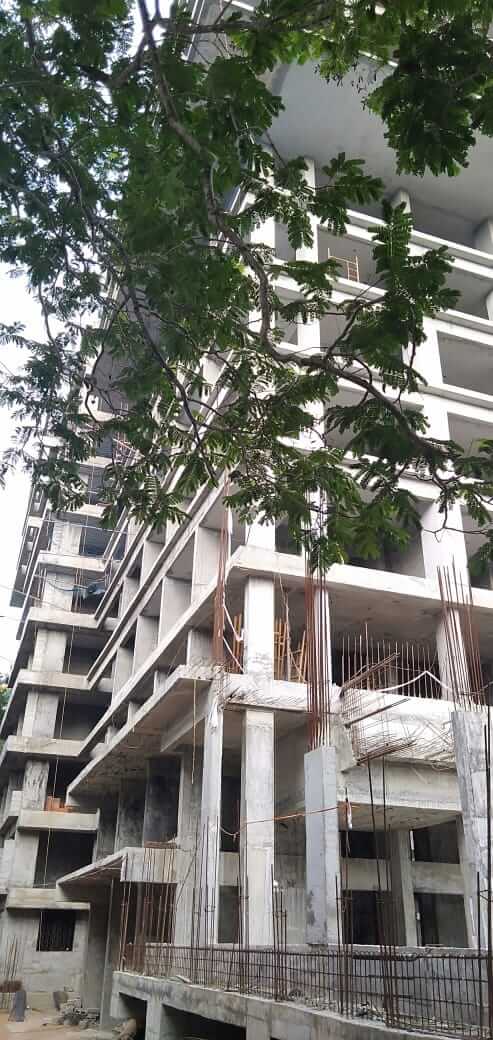

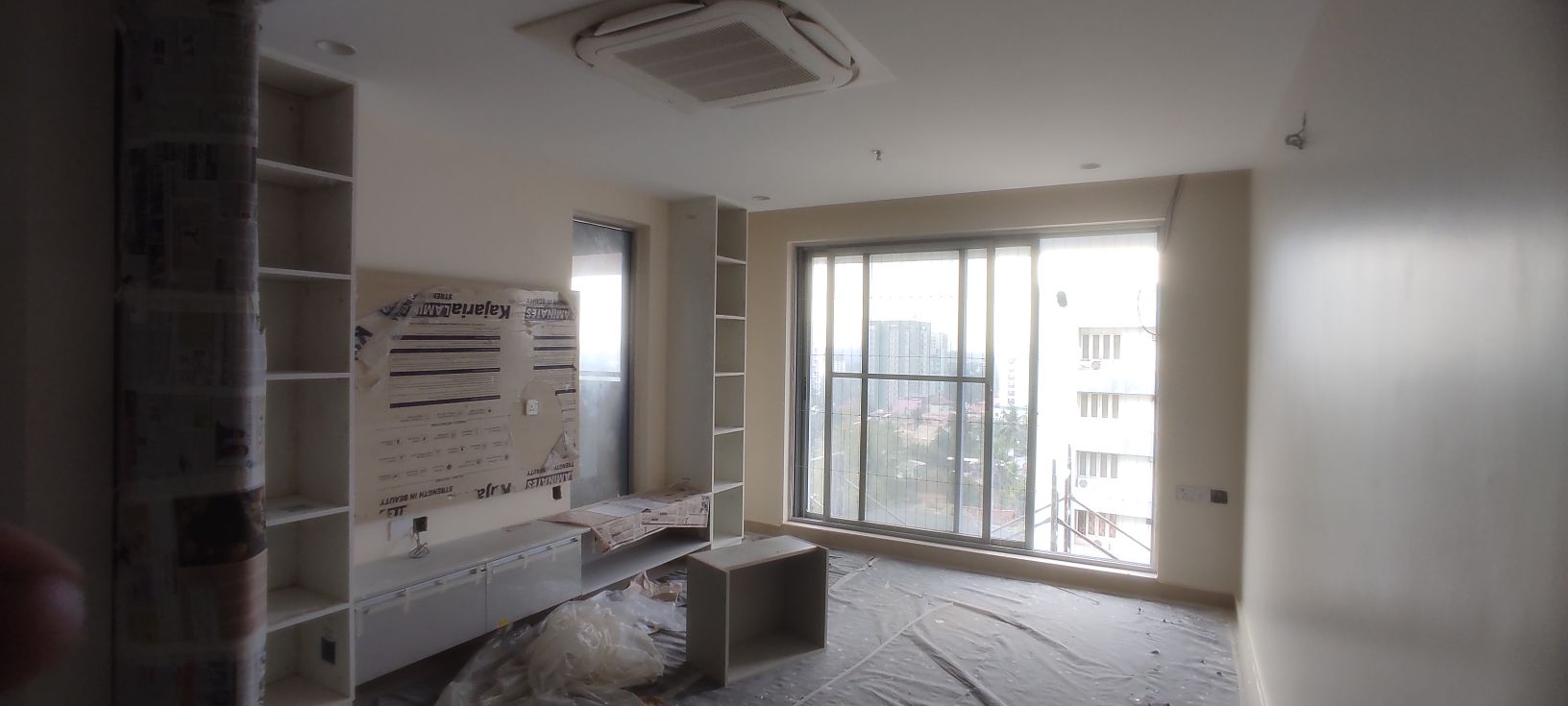

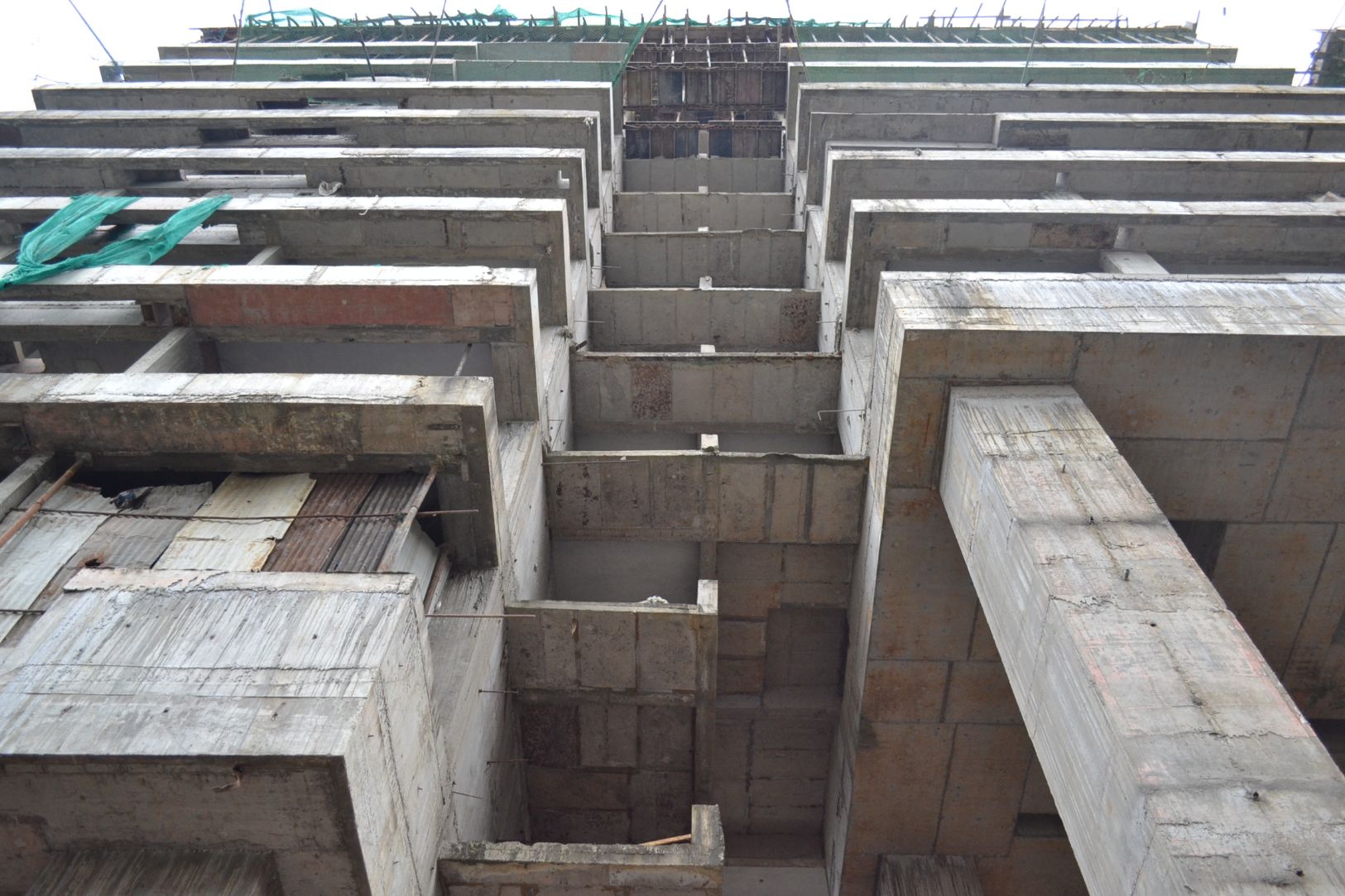

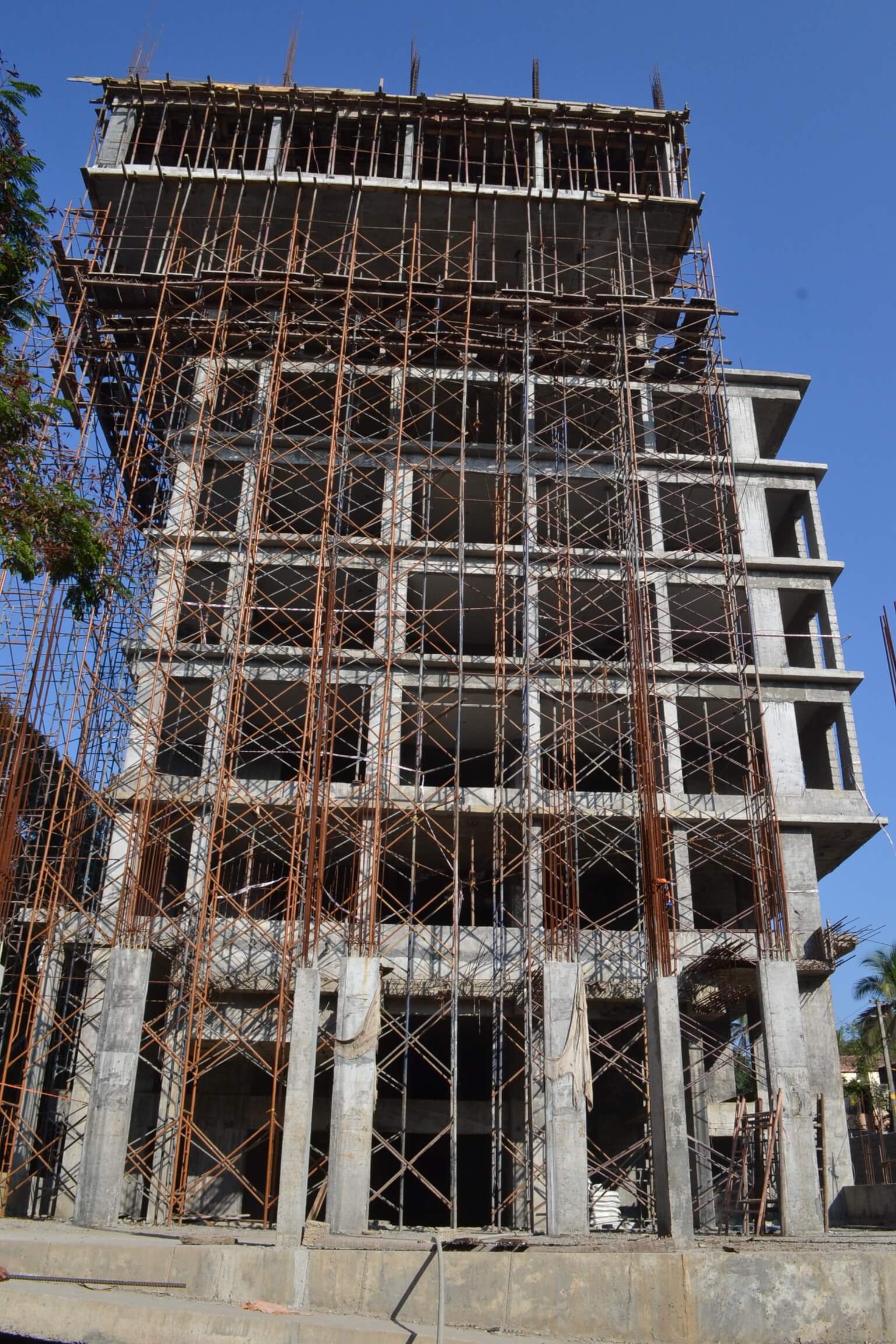

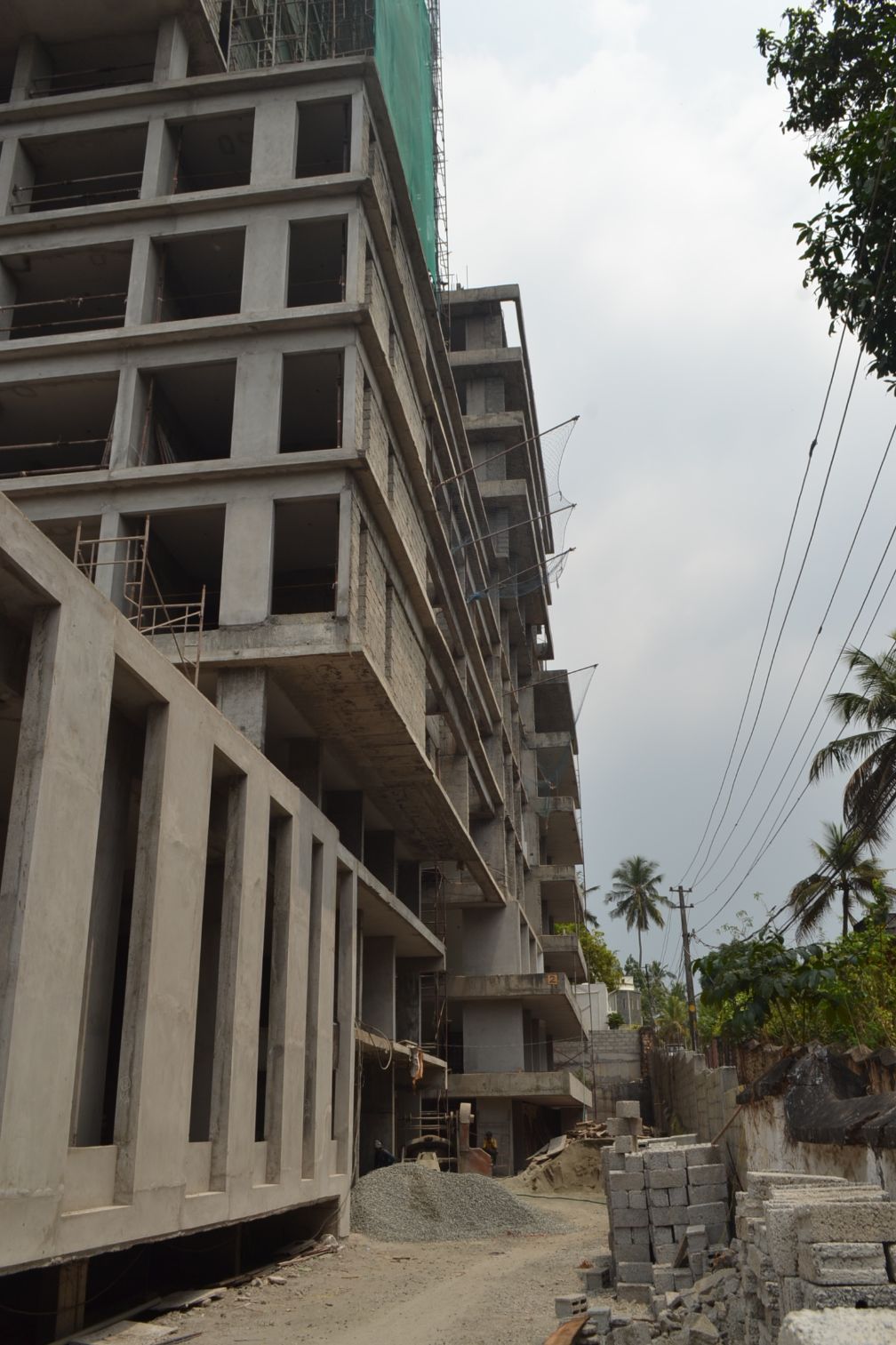

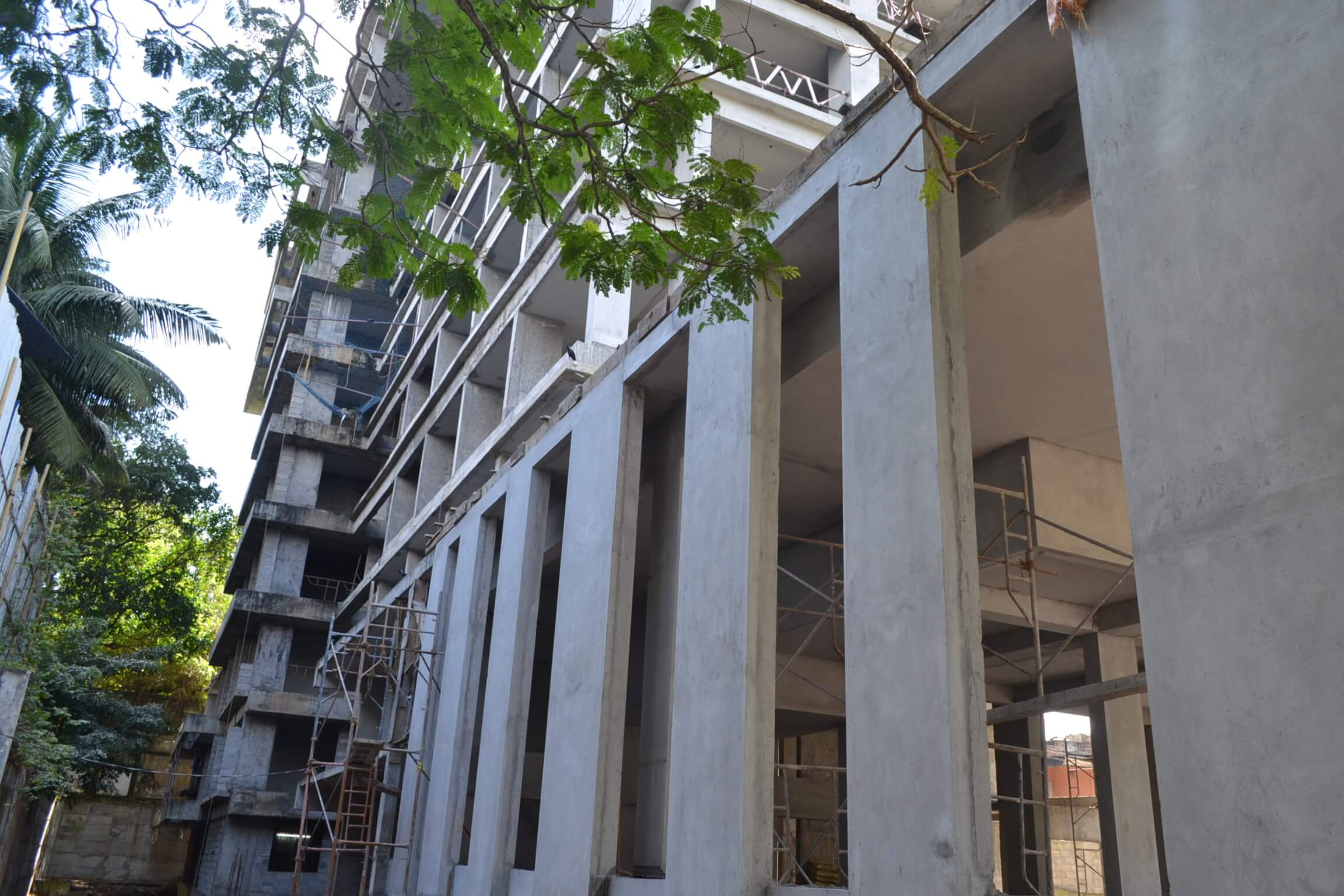

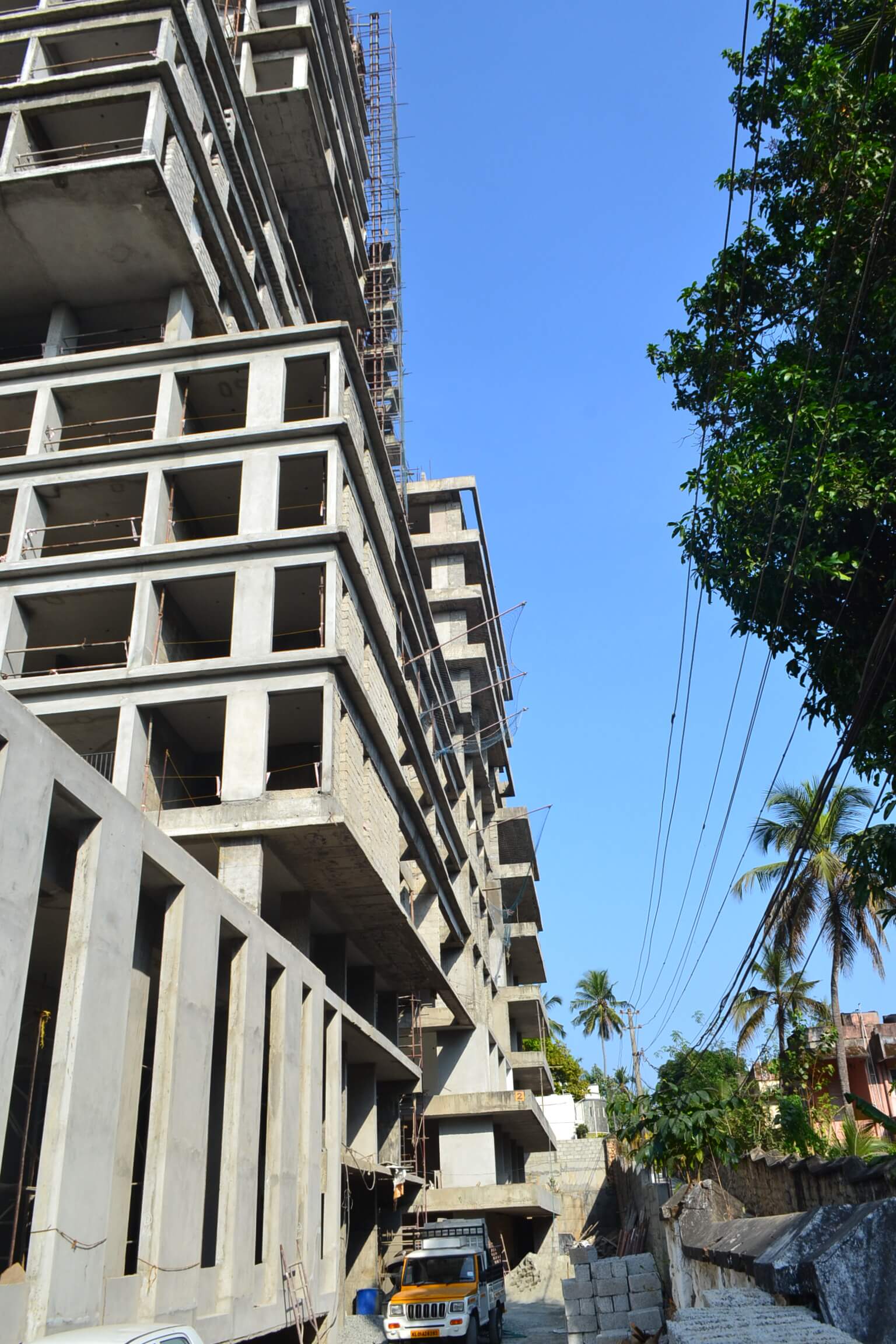

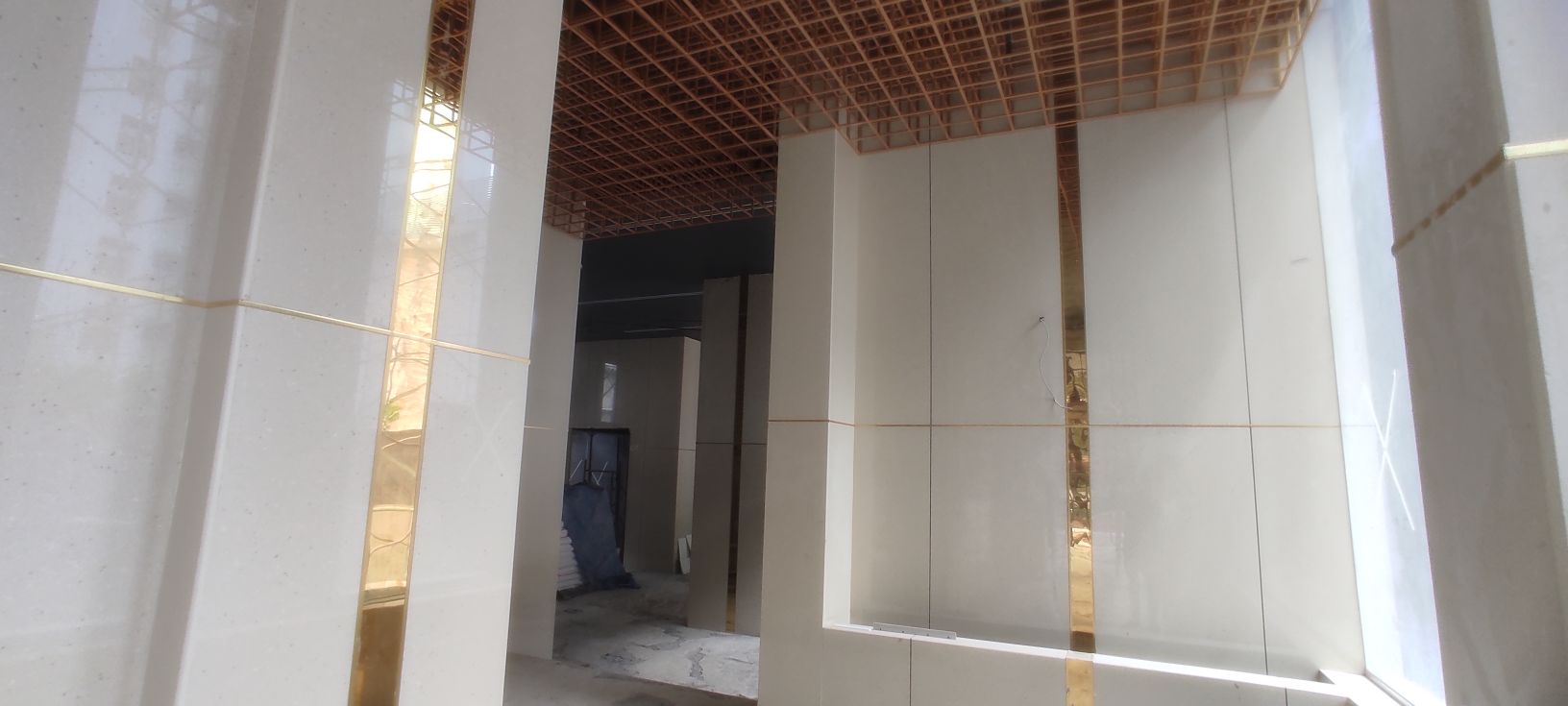

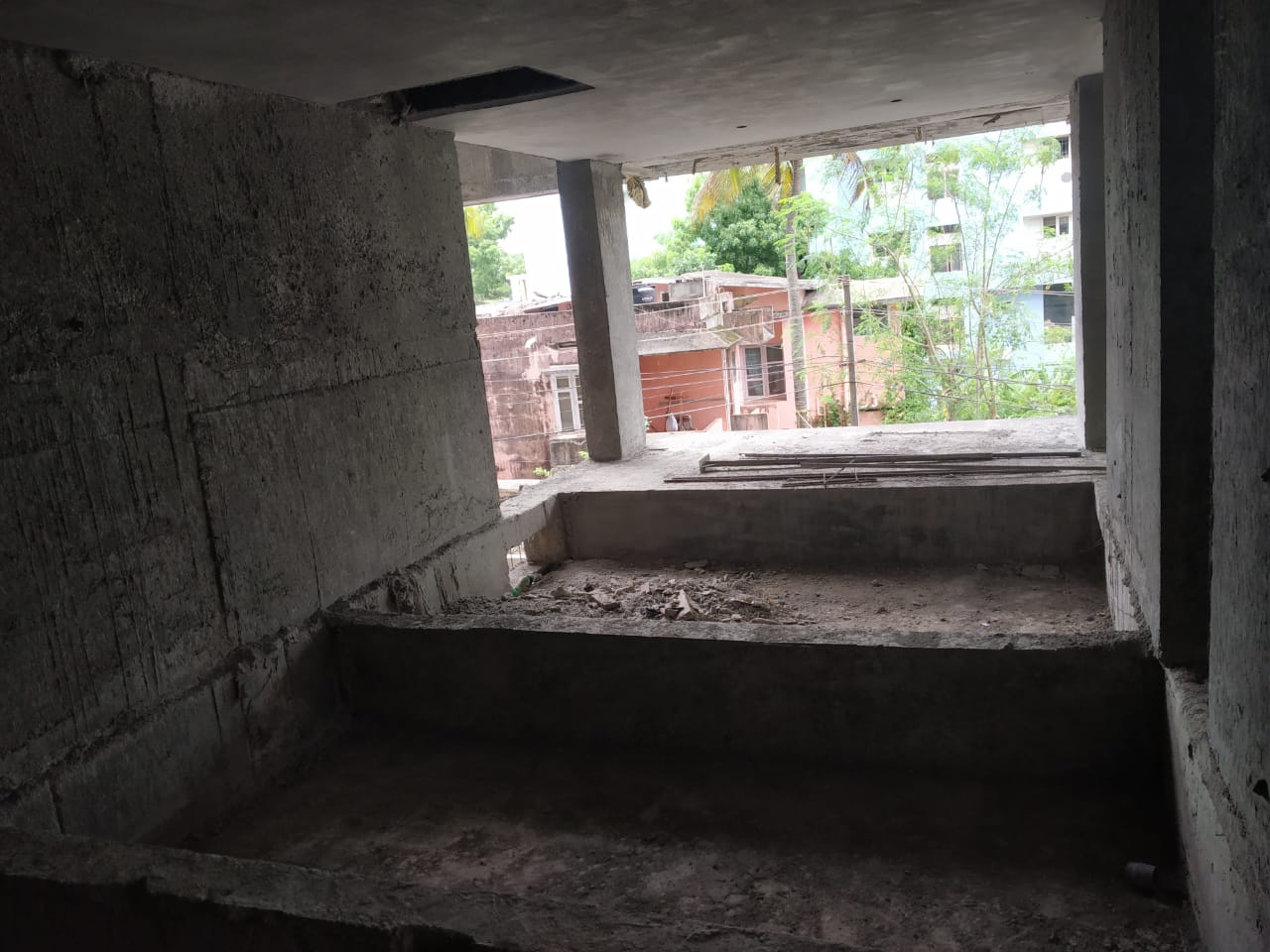

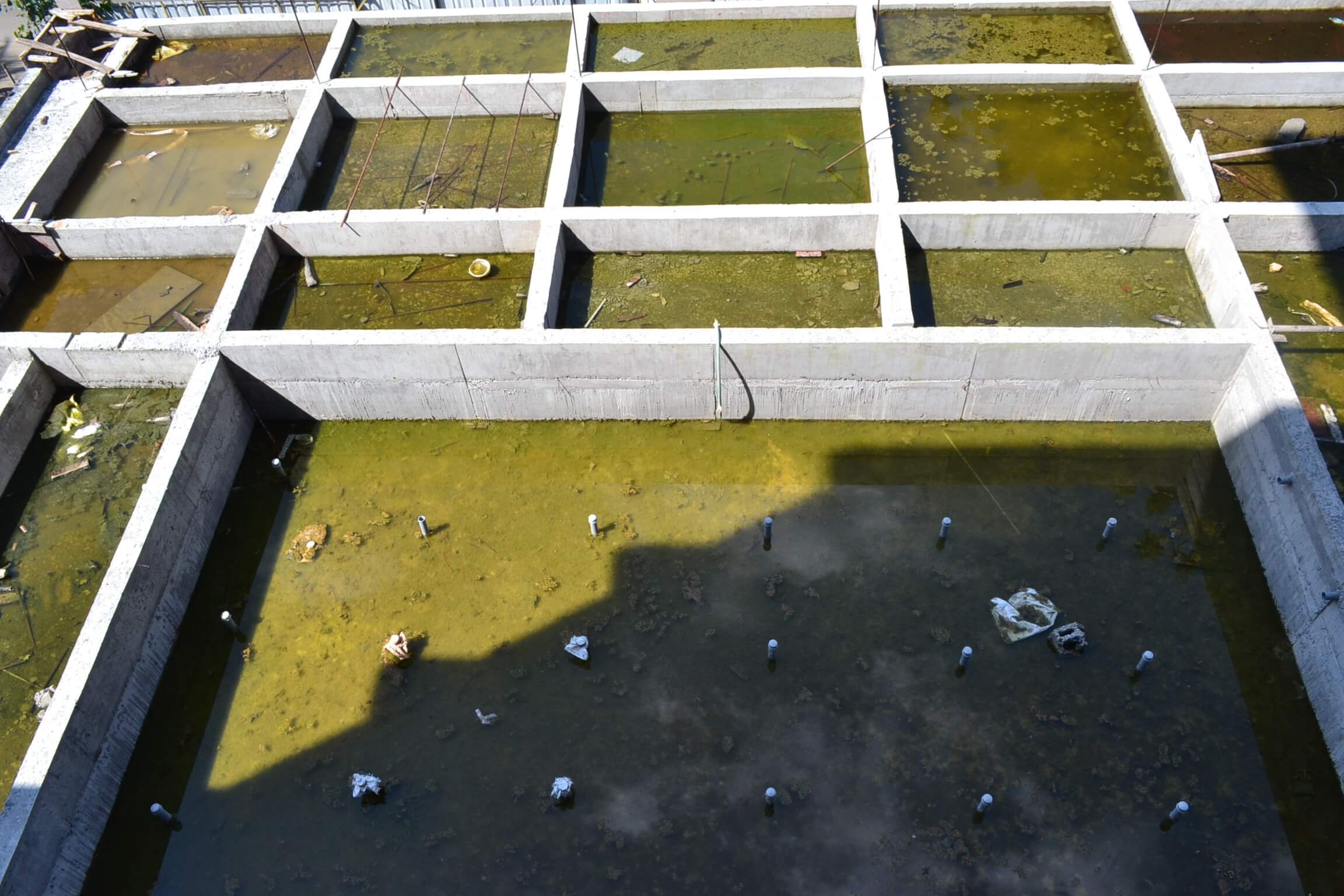

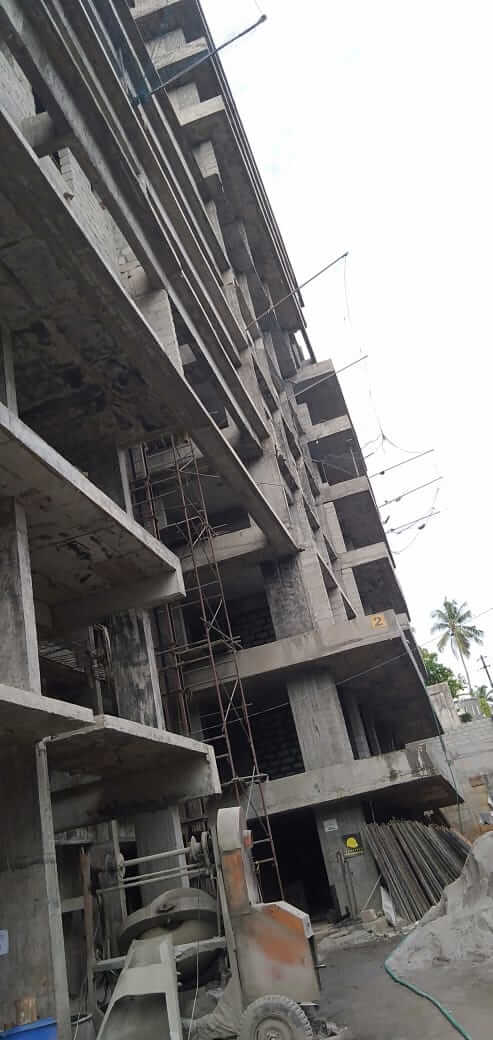

Artech Diamond Enclave - PROGRESS

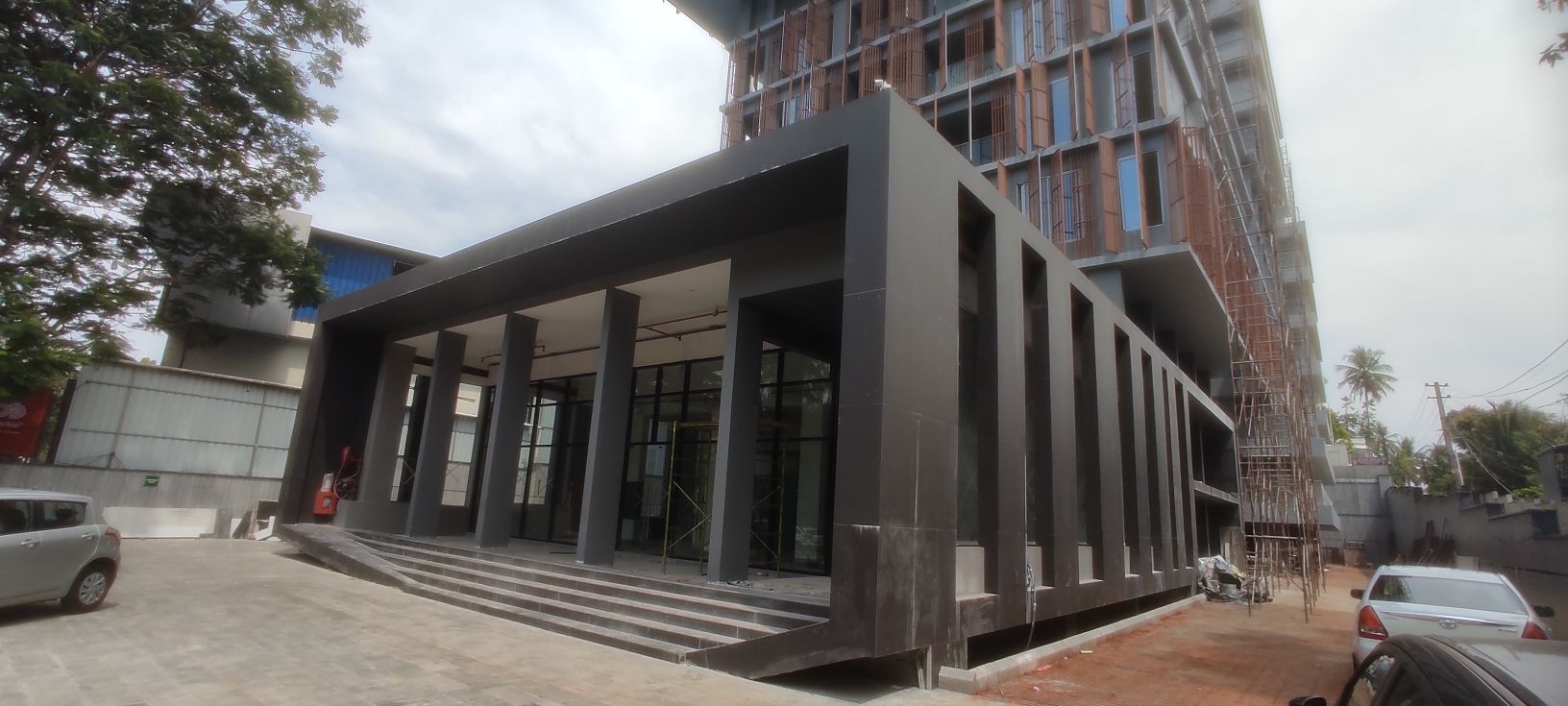

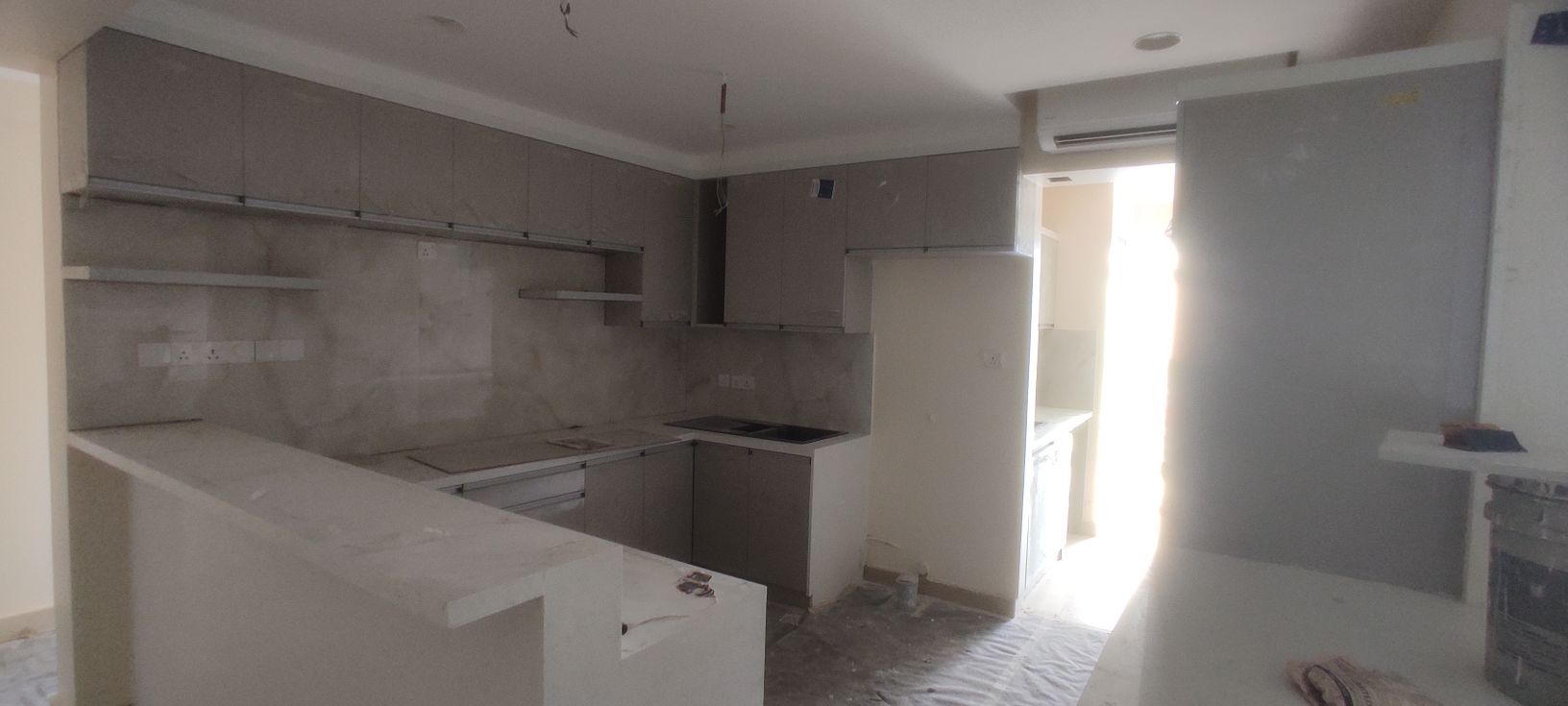

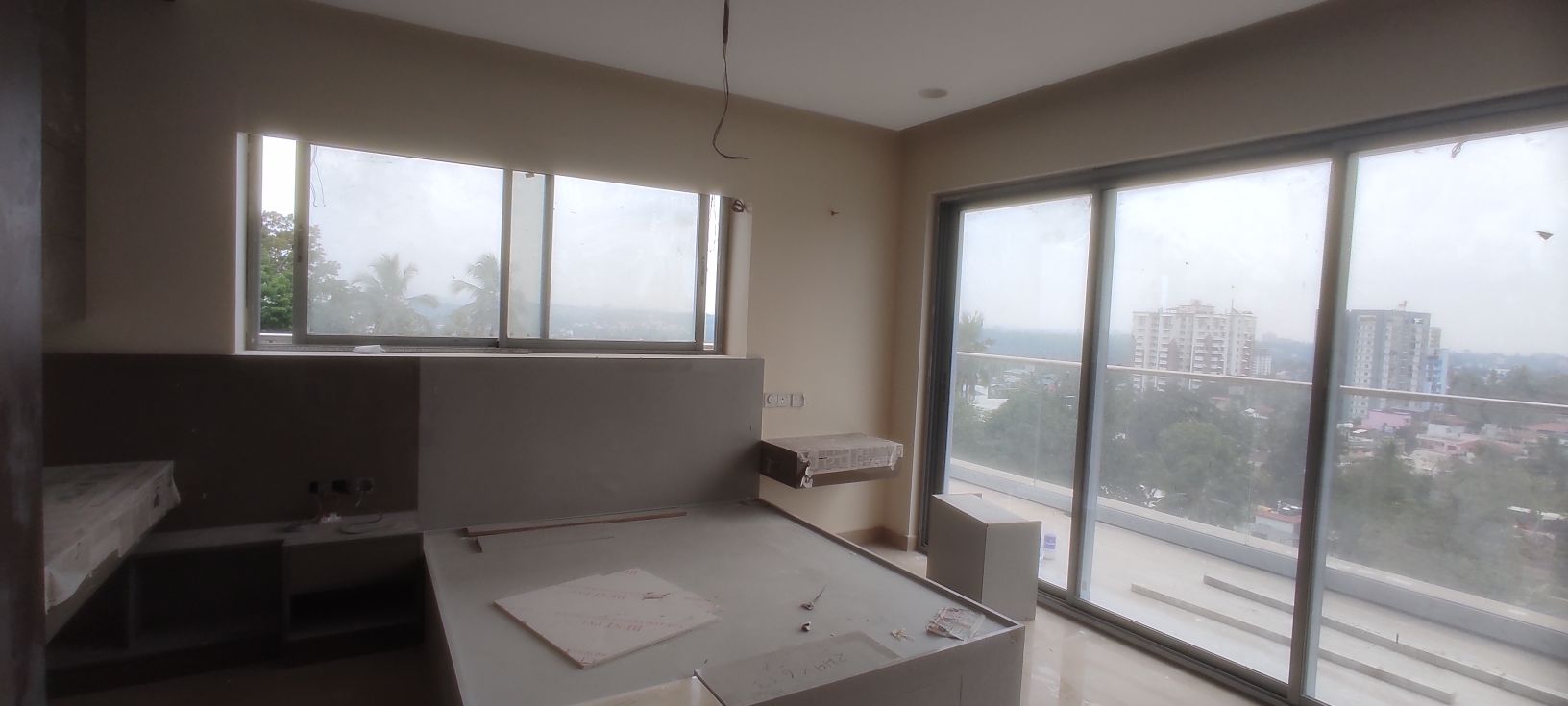

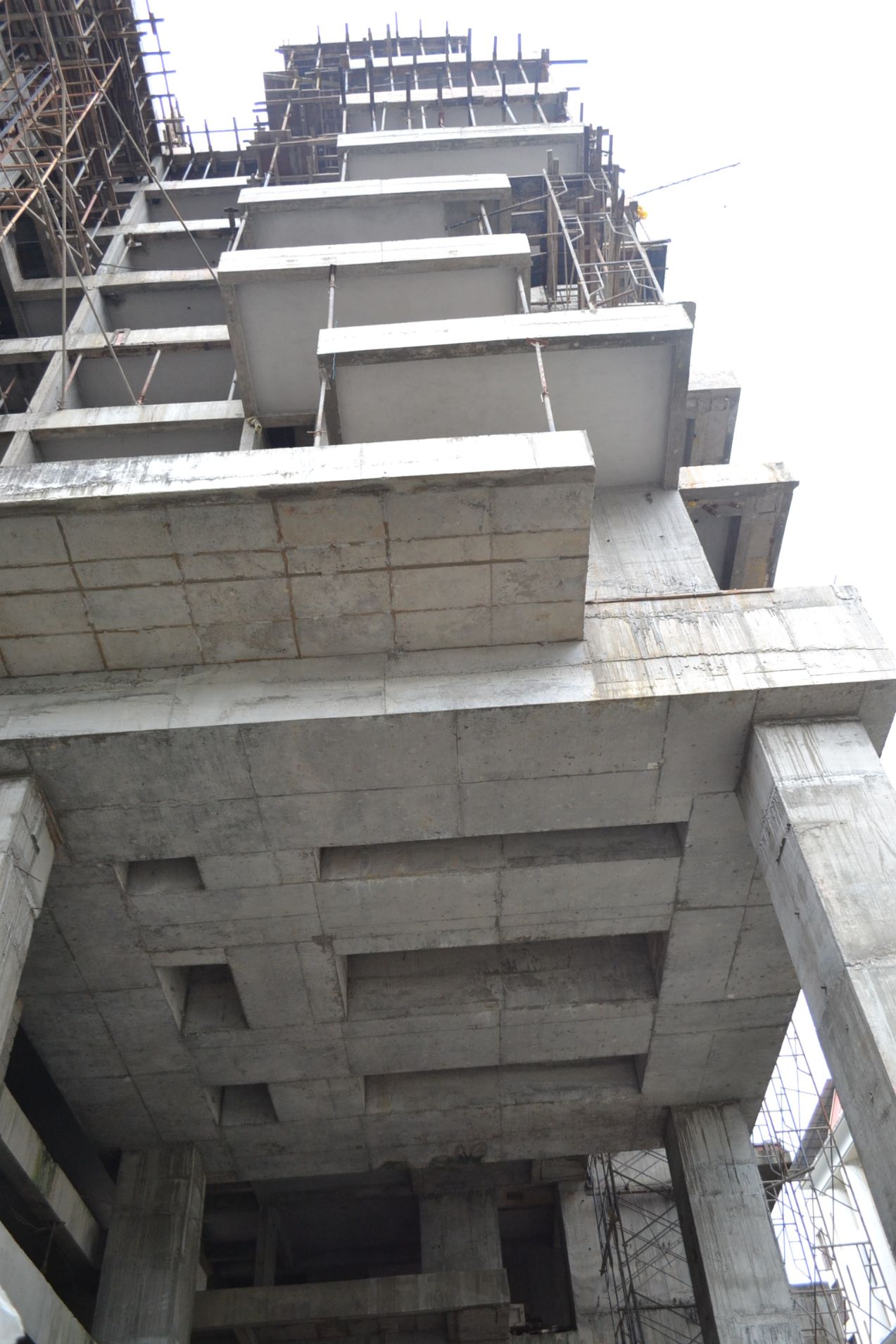

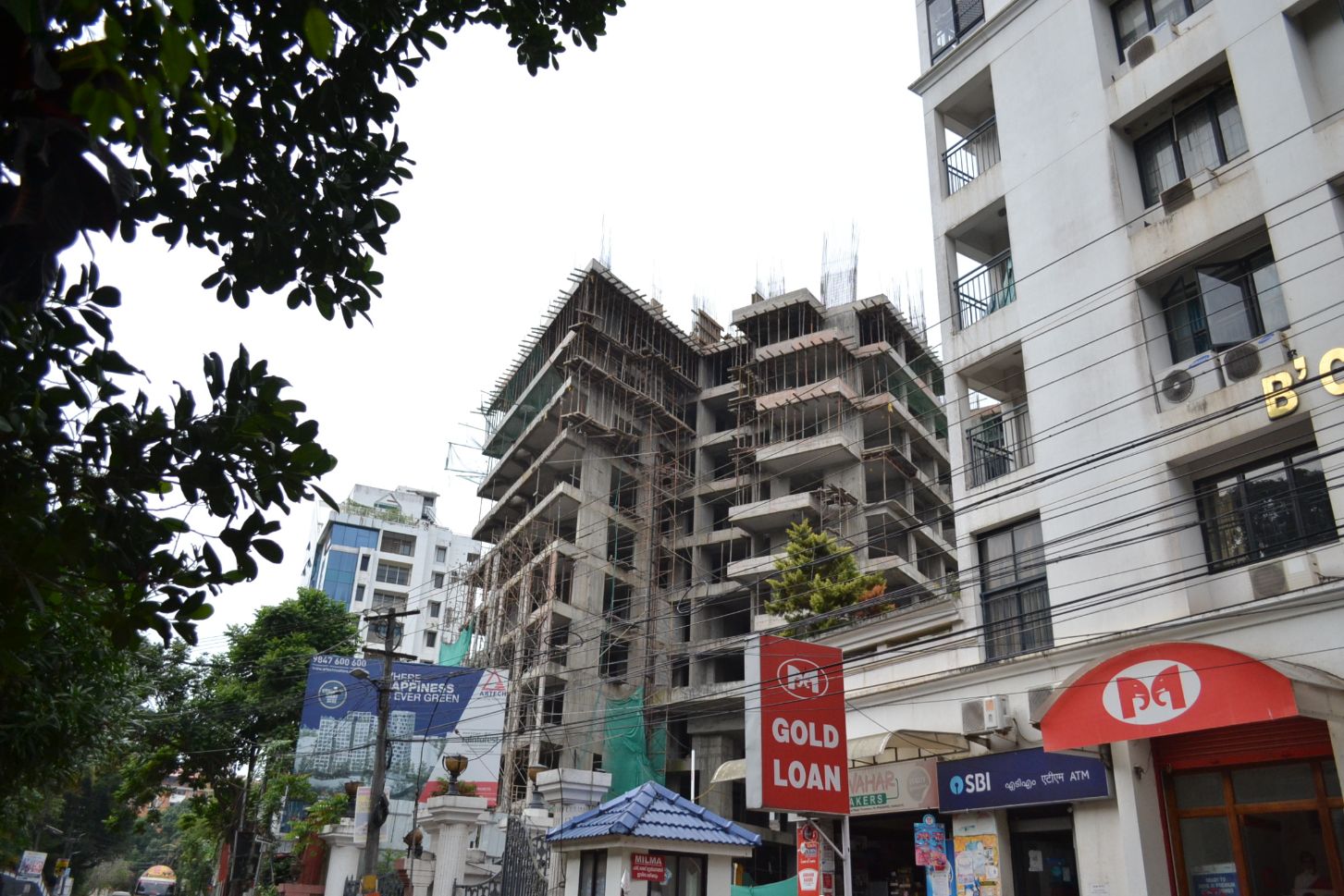

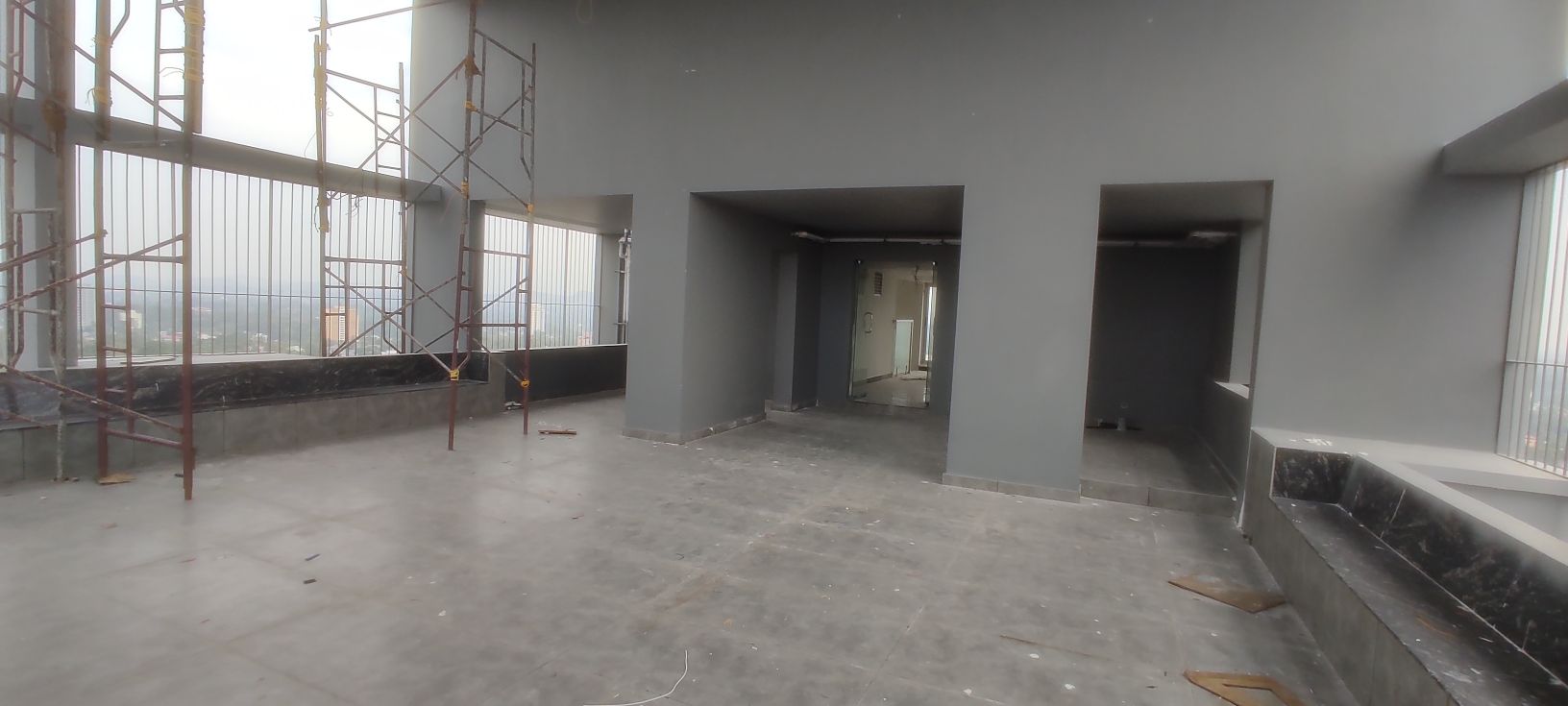

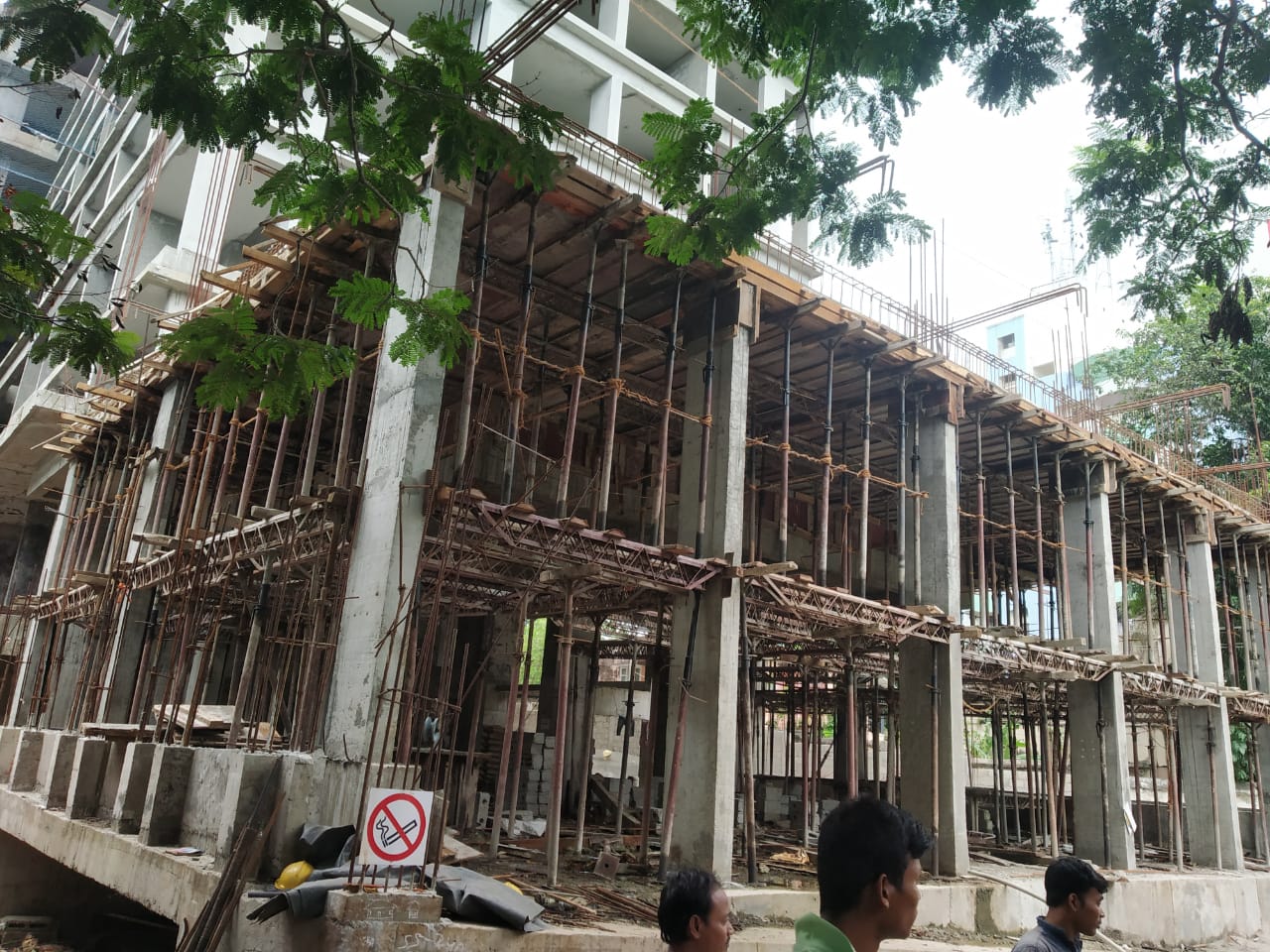

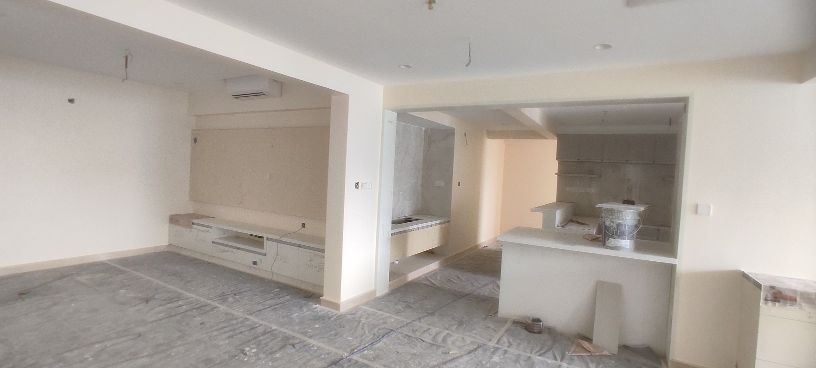

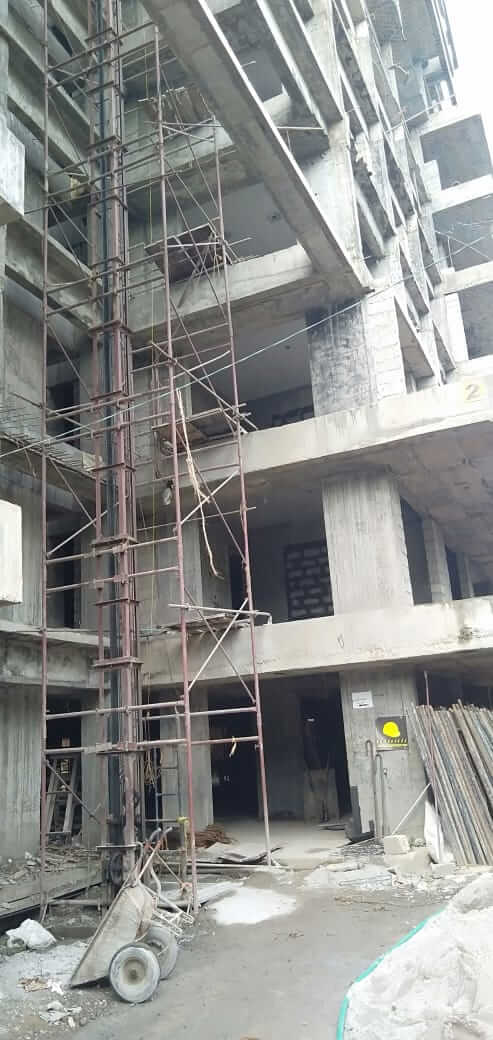

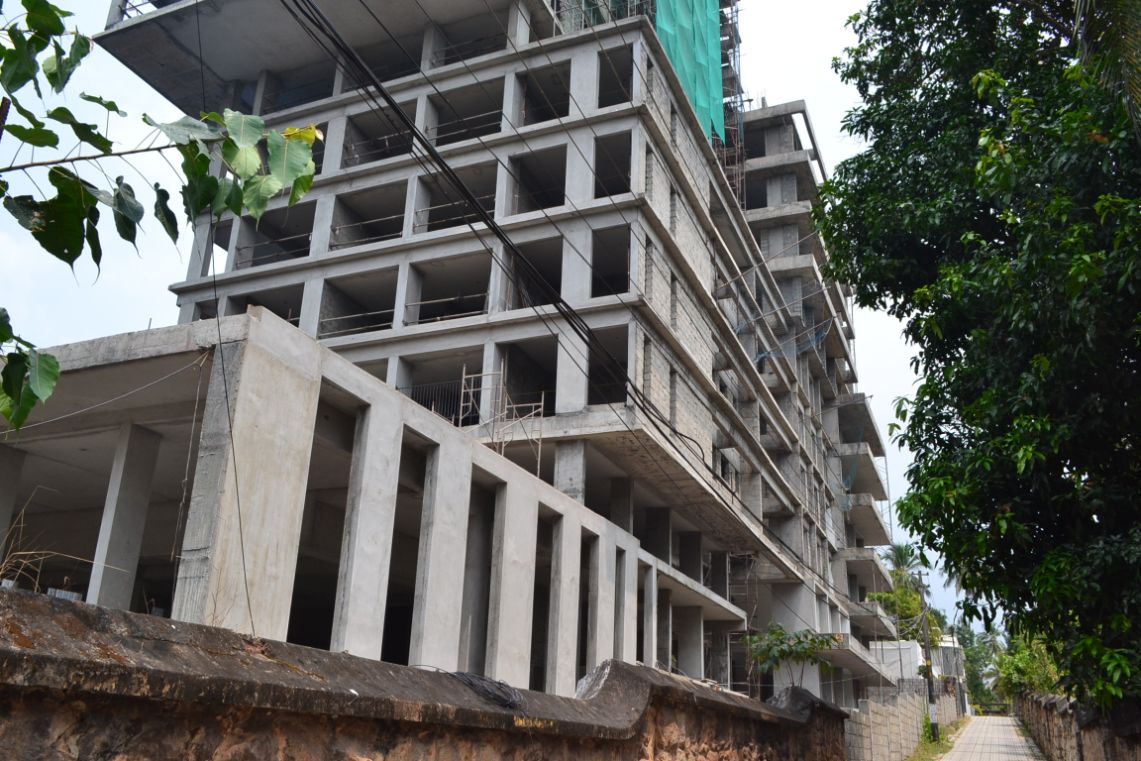

Work status as on 08-03-2023, we have completed the following.

  • Structural Works – All sub-structural and structural works – Completed
  • Civil Works – Ceiling plastering and wall plastering, Masonry – Block/ brick, Screeding – Completed
  • Internal Finishes – Main door – 99% completed, Waterproofing – 99% Completed, Wall tiling – 99% Completed, Flooring – 99% Completed, putty works & Painting – 95% Completed , Door frame fixtures – 100% Completed, Handrails – 99% Completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 99% Completed, Wall and floor services, Risers – 98% Completed, Centralised Gas piping system – 99% Completed
  • Final Finishes – Door shutters & ironmongery – 70% Completed, Firefighting final fixtures – 99% Completed
  • External Finishes – Windows & Sliding doors – 95% Completed, External Plastering – 100% Completed, External Painting – 95% Completed, Louvers/ Façade/ Wall cladding – 92% Completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – Primer application completed

As per the current work status from our site, we are targeted to complete the following works by the end of MARCH 2023.

  • Internal Finishes – Main Door – 100% to be completed, Water Proofing – 100% to be completed, Wall tiling – 100% to be completed, Flooring – 100% to be completed, putty works and painting – 100% to be completed, Handrails – 100% to be completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 100% to be completed, Wall and floor services, Risers – 100% to be completed, Centralised Gas Piping System – 100% to be completed
  • Final Finishes – Firefighting final fixtures – 100% to be completed
  • External Finishes – Windows & Sliding door- 100% to be completed, External Painting – 98% to be completed, Louvres/ Façade/ Wall cladding – 95% to be completed
  • Mockup – Interior work 100% to be Completed.

Work status as on 11-02-2023, we have completed the following.

  • Structural Works – All sub-structural and structural works – Completed
  • Civil Works – Ceiling plastering and wall plastering, Masonry – Block/ brick, Screeding – Completed
  • Internal Finishes – Main door – 99% completed, Waterproofing – 99% Completed, Wall tiling – 99% Completed, Flooring – 99% Completed, putty works & Painting – 95% Completed , Door frame fixtures – 100% Completed, Handrails – 99% Completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 98% Completed, Wall and floor services, Risers – 98% Completed, Centralised Gas piping system – 99% Completed
  • Final Finishes – Door shutters & ironmongery – 50% Completed, Firefighting final fixtures – 99% Completed
  • External Finishes – Windows & Sliding doors – 94% Completed, External Plastering – 100% Completed, External Painting – 90% Completed, Louvers/ Façade/ Wall cladding – 90% Completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – Primer application completed

As per the current work status from our site, we are targeted to complete the following works by the end of FEBRUARY 2023.

  • Internal Finishes – Main Door – 100% to be completed, Water Proofing – 100% to be completed, Wall tiling – 100% to be completed, Flooring – 100% to be completed, putty works and painting – 100% to be completed, Handrails – 100% to be completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 100% to be completed, Wall and floor services, Risers – 100% to be completed, Centralised Gas Piping System – 100% to be completed
  • Final Finishes – Firefighting final fixtures – 100% to be completed
  • External Finishes – Windows & Sliding door- 100% to be completed, External Painting – 95% to be completed, Louvres/ Façade/ Wall cladding – 95% to be completed
  • Mockup – Interior work 100% to be Completed.

Work status as on 14-01-2023, we have completed the following.

  • Structural Works – All sub-structural and structural works – Completed
  • Civil Works – Ceiling plastering and wall plastering, Masonry – Block/ brick, Screeding – Completed
  • Internal Finishes – Main door – 99% completed, Waterproofing – 99% Completed, Wall tiling – 99% Completed, Flooring – 98% Completed, putty works & Painting – 95% Completed , Door frame fixtures – 100% Completed, Handrails – 99% Completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 98% Completed, Wall and floor services, Risers – 98% Completed, Centralised Gas piping system – 99% Completed
  • Final Finishes – Door shutters & ironmongery – 45% Completed, Firefighting final fixtures – 99% Completed
  • External Finishes – Windows & Sliding doors – 93% Completed, External Plastering – 100% Completed, External Painting – 85% Completed, Louvers/ Façade/ Wall cladding – 85% Completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – Primer application completed

As per the current work status from our site, we are targeted to complete the following works by the end of JANUARY 2023.

  • Internal Finishes – Main Door – 100% to be completed, Water Proofing – (BF)100% to be completed, Wall tiling – 100% to be completed, Flooring – 100% to be completed, putty works and painting – 100% to be completed, Handrails – 100% to be completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 100% to be completed, Wall and floor services, Risers – 100% to be completed, Centralised Gas Piping System – 100% to be completed
  • Final Finishes – Firefighting final fixtures – 100% to be completed
  • External Finishes – Windows & Sliding door- 100% to be completed, External Painting – 90% to be completed, Louvres/ Façade/ Wall cladding – 90% to be completed
  • Mockup – Interior work 100% to be Completed.

As per the current work status from our site, we are targeted to complete the following works by the end of DECEMBER 2022.

  • Internal Finishes – Main Door – 100% to be completed, Water Proofing – (BF)100% to be completed, Wall tiling – 100% to be completed, Flooring – 100% to be completed, putty works and painting – 100% to be completed, Handrails – 100% to be completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 100% to be completed, Wall and floor services, Risers – 100% to be completed, Centralised Gas Piping System – 100% to be completed
  • Final Finishes – Firefighting final fixtures – 100% to be completed
  • External Finishes – Windows & Sliding door- 100% to be completed, External Painting – 90% to be completed, Louvres/ Façade/ Wall cladding – 90% to be completed
  • Mockup – Interior work 100% to be Completed.

Work status as on 13-12-2022, we have completed the following.

  • Structural Works – All sub-structural and structural works – Completed
  • Civil Works – Ceiling plastering and wall plastering, Masonry – Block/ brick, Screeding – Completed
  • Internal Finishes – Main door – 99% completed, Waterproofing – 99% Completed, Wall tiling – 99% Completed, Flooring – 98% Completed, putty works & Painting – 95% Completed , Door frame fixtures – 100% Completed, Handrails – 99% Completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 98% Completed, Wall and floor services, Risers – 98% Completed, Centralised Gas piping system – 99% Completed
  • Final Finishes – Door shutters & ironmongery – 45% Completed, Firefighting final fixtures – 99% Completed
  • External Finishes – Windows & Sliding doors – 93% Completed, External Plastering – 100% Completed, External Painting – 85% Completed, Louvers/ Façade/ Wall cladding – 85% Completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – Primer application completed

As per the current work status from our site, we are targeted to complete the following works by the end of NOVEMBER 2022.

  • Internal Finishes – Main Door – 100% to be completed, Water Proofing – (BF)100% to be completed, Wall tiling – 100% to be completed, Flooring – 100% to be completed, putty works and painting – 100% to be completed, Handrails – 100% to be completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 100% to be completed, Wall and floor services, Risers – 99% to be completed, Centralised Gas Piping System – 100% to be completed
  • Final Finishes – Firefighting final fixtures – 100% to be completed
  • External Finishes – Windows & Sliding door- 100% to be completed, External Painting – 90% to be completed, Louvres/ Façade/ Wall cladding – 90% to be completed
  • Mockup – Interior work 100% to be Completed.

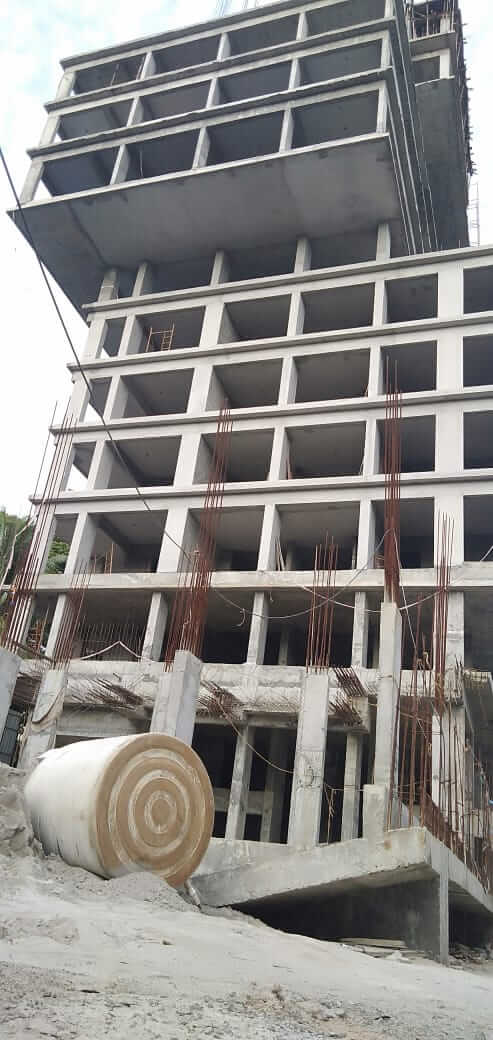

Work status as on 15-11-2022, we have completed the following.

  • Structural Works – All sub-structural and structural works – Completed
  • Civil Works – Ceiling plastering and wall plastering, Masonry – Block/ brick, Screeding – Completed
  • Internal Finishes – Main door – 99% completed, Waterproofing – 99% Completed, Wall tiling – 99% Completed, Flooring – 98% Completed, putty works & Painting – 94% Completed , Door frame fixtures – 100% Completed, Handrails – 99% Completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 98% Completed, Wall and floor services, Risers – 97% Completed, Centralised Gas piping system – 99% Completed
  • Final Finishes – Door shutters & ironmongery – 42% Completed, Firefighting final fixtures – 99% Completed
  • External Finishes – Windows & Sliding doors – 93% Completed, External Plastering – 100% Completed, External Painting – 85% Completed, Louvers/ Façade/ Wall cladding – 85% Completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – Primer application completed

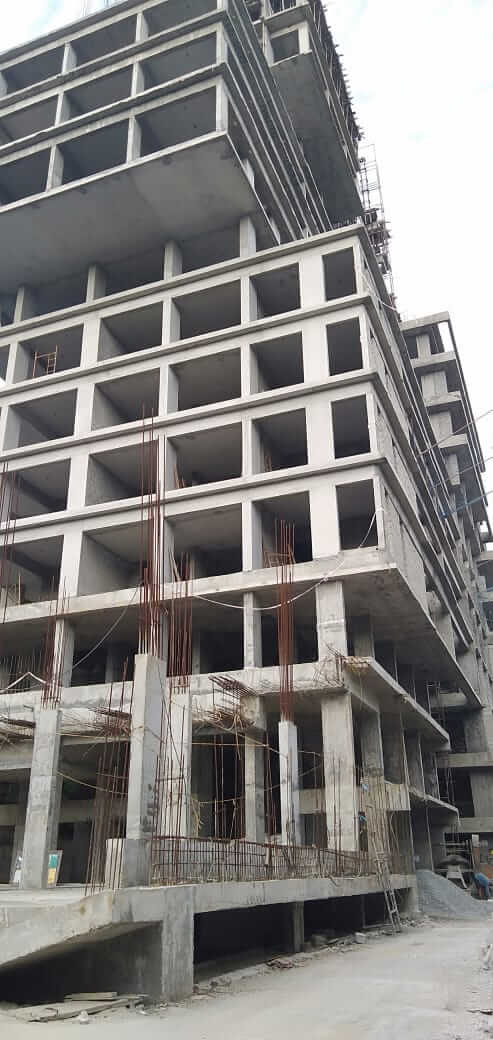

Work status as on 11-10-2022, we have completed the following

  • Structural Works – All sub-structural and structural works – Completed
  • Civil Works – Ceiling plastering and wall plastering, Masonry – Block/ brick, Screeding – Completed
  • Internal Finishes – Main door – 99% completed, Waterproofing – 99% Completed, Wall tiling – 98% Completed, Flooring – 98% Completed, putty works & Painting – 93% Completed , Door frame fixtures – 100% Completed, Handrails – 99% Completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 98% Completed, Wall and floor services, Risers – 97% Completed, Centralised Gas piping system – 99% Completed, corridor handrail works – 85% completed
  • Final Finishes – Door shutters & ironmongery – 40% Completed, Firefighting final fixtures – 99% Completed
  • External Finishes – Windows & Sliding doors – 92% Completed, External Plastering – 100% Completed, External Painting – 82% Completed, Louvers/ Façade/ Wall cladding – 80% Completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – Primer application completed

As per the current work status from our site, we are targeted to complete the following works by the end of OCTOBER 2022.

  • Internal Finishes – Main Door – 100% to be completed, Water Proofing – 100% to be completed, Wall tiling – 100% to be completed, Flooring – 100% to be completed, putty works and painting – 95% to be completed, Handrails – 100% to be completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 100% to be completed, Wall and floor services, Risers – 99% to be completed, Centralised Gas Piping System – 100% to be completed, corridor handrail works – 95% to be completed
  • Final Finishes – Firefighting final fixtures – 100% to be completed
  • External Finishes – Windows & Sliding door- 100% to be completed, External Painting – 87% to be completed, Louvres/ Façade/ Wall cladding – 90% to be completed
  • Mockup – Interior work 100% to be Completed.

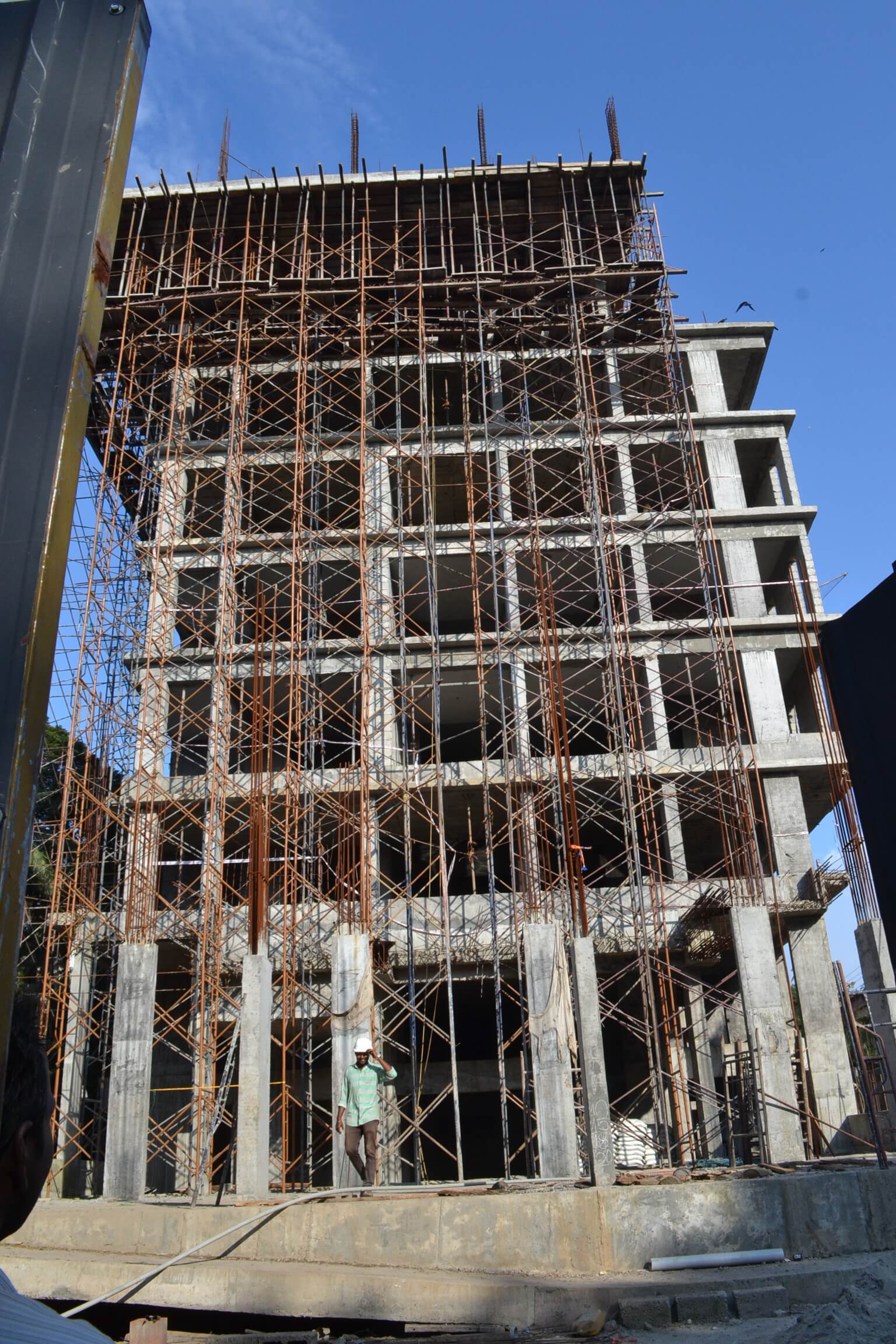

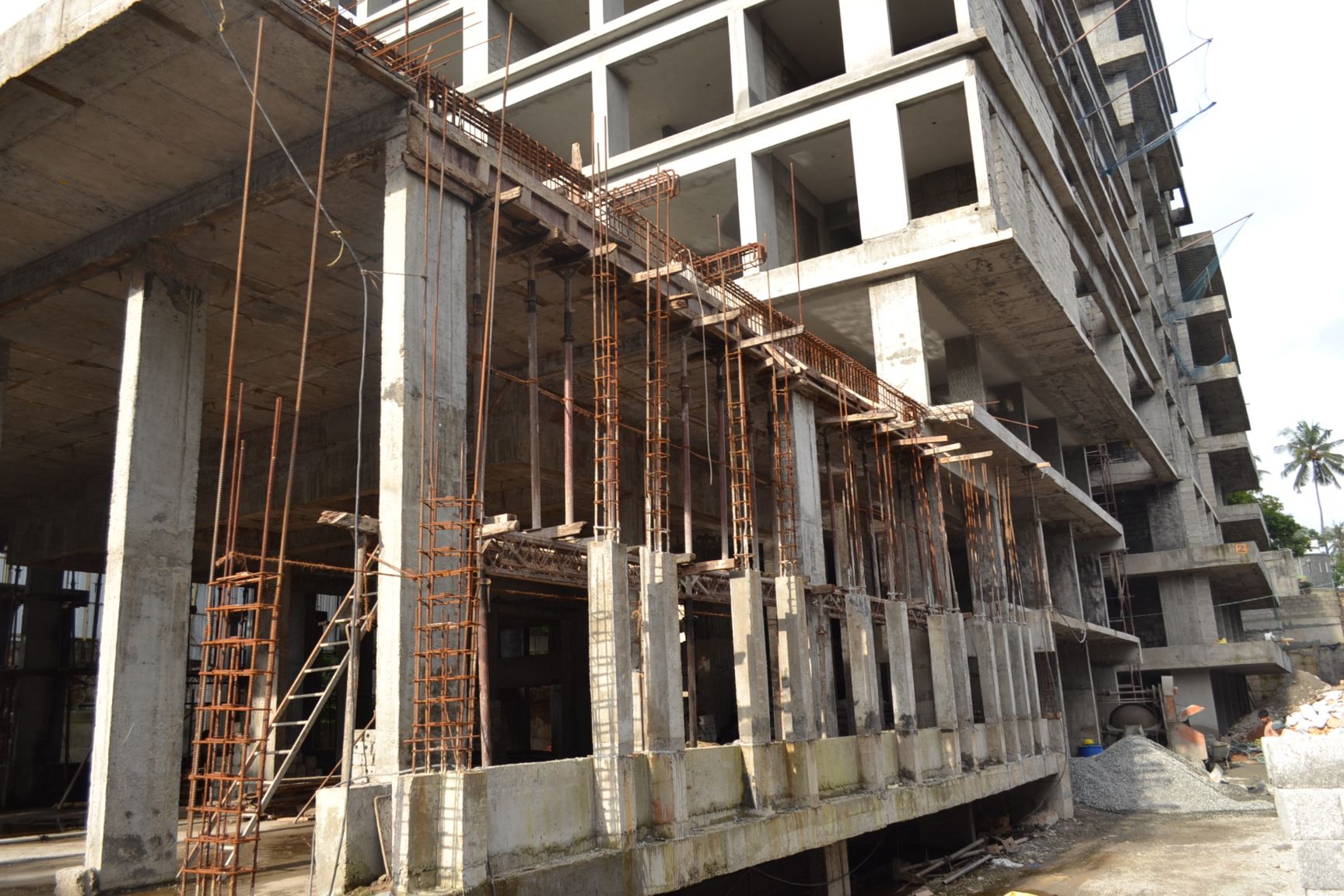

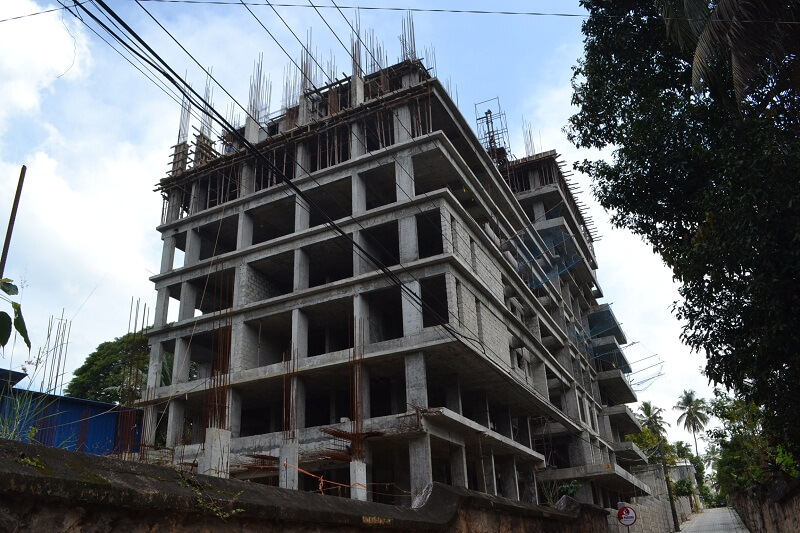

Work status as on 17-09-2022, we have completed the following.

  • Structural Works – All sub-structural and structural works – 100% Completed
  • Civil Works – Ceiling plastering and wall plastering – 100% completed, Masonry – Block/ brick – 100% completed, Screeding – 99% Completed
  • Internal Finishes – Main door – 99% completed, Waterproofing – 99% Completed, Wall tiling – 98% Completed, Flooring – 98% Completed, putty works & Painting – 92% Completed , Door frame fixtures – 100% Completed, Handrails – 99% Completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 98% Completed, Wall and floor services, Risers – 95% Completed, Centralised Gas piping system – 99% Completed
  • Final Finishes – Door shutters & ironmongery – 35% Completed, Firefighting final fixtures – 99% Completed
  • External Finishes – Windows & Sliding doors – 89% Completed, External Plastering – 100% Completed, External Painting – 80% Completed, Louvers/ Façade/ Wall cladding – 80% Completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – Primer application completed

As per the current work status from our site, we are targeted to complete the following works by the end of SEPTEMBER 2022.

  • Civil Works – Screeding – 100% to be completed
  • Internal Finishes – Main Door – 100% to be completed, Water Proofing – 100% to be completed, Wall tiling – 100% to be completed, Flooring – 100% to be completed, putty works and painting – 95% to be completed, Handrails – 100% to be completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 100% to be completed, Wall and floor services, Risers – 98% to be completed, Centralised Gas Piping System – 100% to be completed
  • Final Finishes – Firefighting final fixtures – 100% to be completed
  • External Finishes – Windows & Sliding door- 100% to be completed, External Painting – 85% to be completed, Louvres/ Façade/ Wall cladding – 90% to be completed
  • Mockup – Interior work 100% to be Completed.

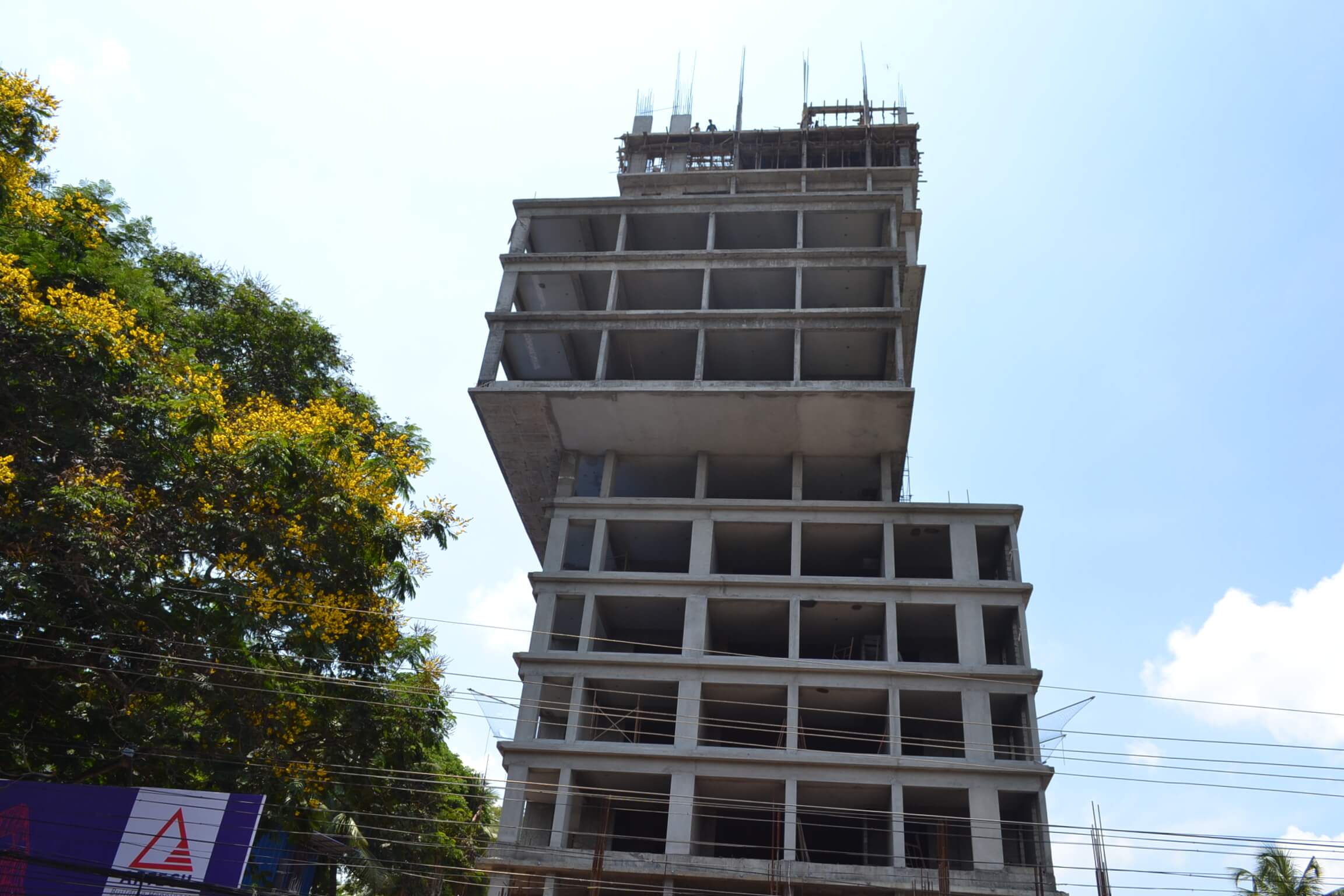

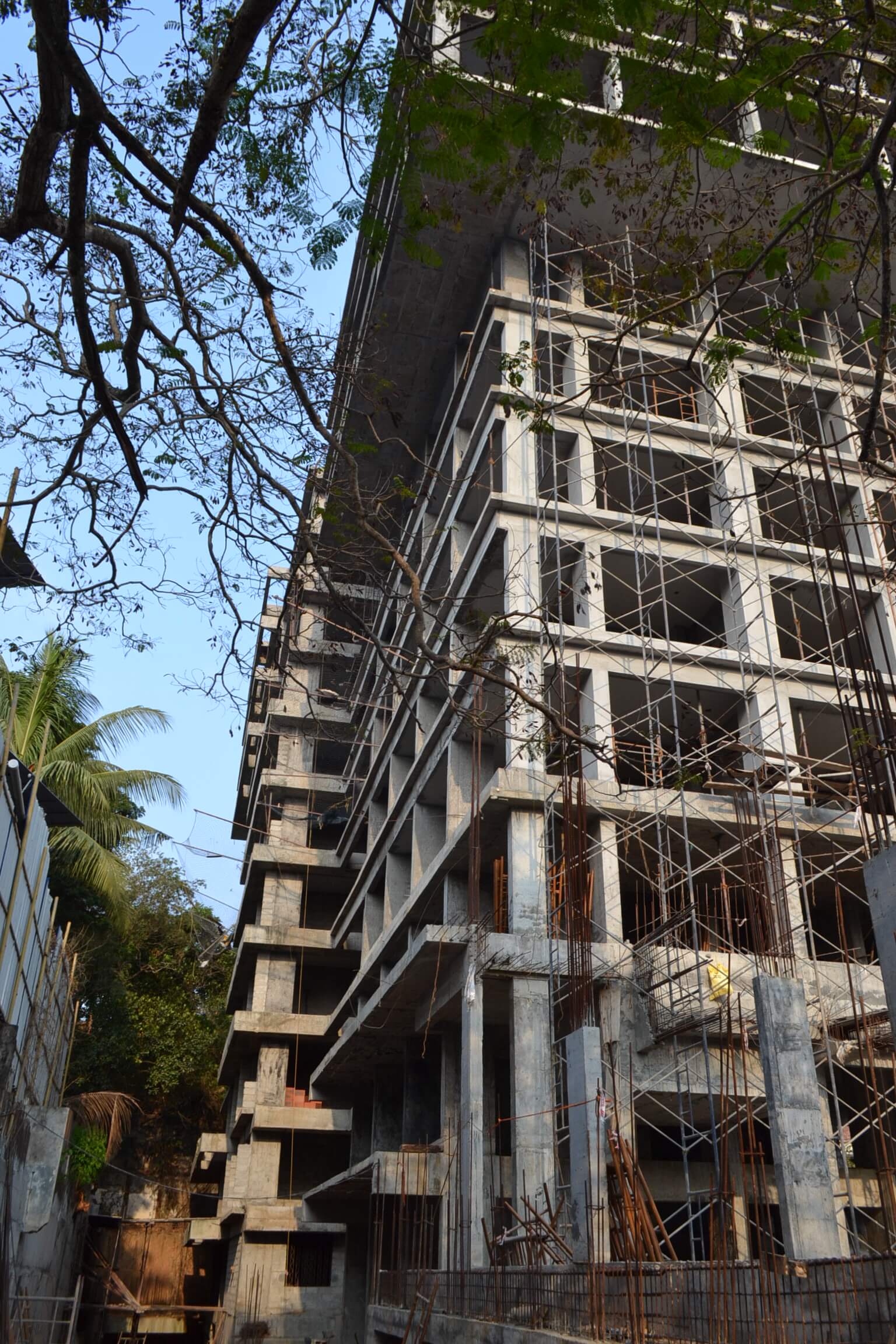

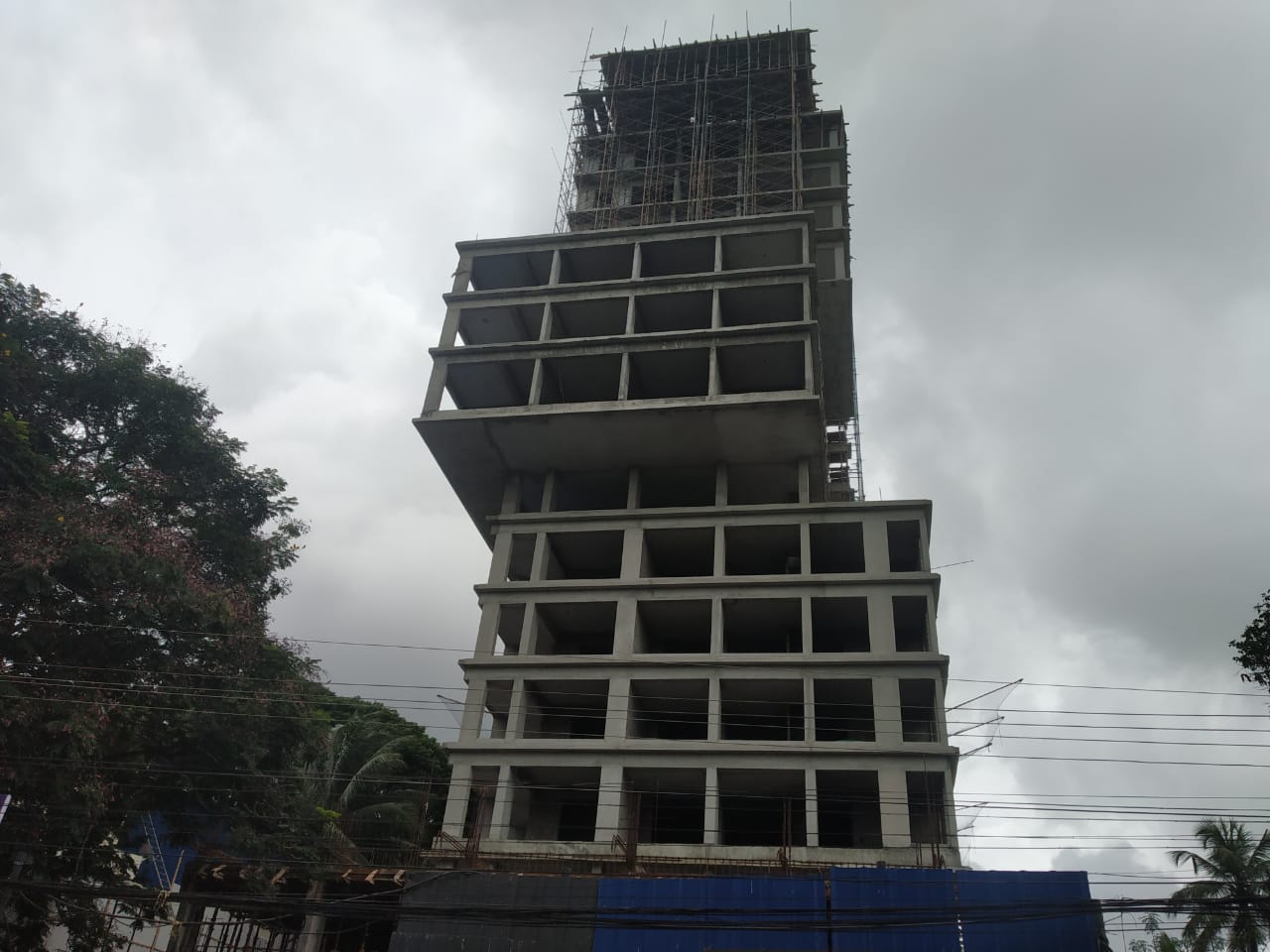

Work status as on 09-07-2022, we have completed the following.

  • Structural Works – All sub-structural and structural works – 100% Completed
  • Civil Works – Ceiling plastering and wall plastering – 100% completed, Masonry – Block/ brick – 100% completed, Screeding – 99% Completed
  • Internal Finishes – Main door – 97% completed, Waterproofing – 99% Completed, Wall tiling – 97% Completed, Flooring – 97% Completed, putty works & Painting – 88% Completed , Door frame fixtures – 100% Completed, Handrails – Balcony handrail 95% Completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 98% Completed, Wall and floor services, Risers – 95% Completed, Centralised Gas piping system – 50% Completed
  • Final Finishes – Door shutters & ironmongery – 20% Completed, Firefighting final fixtures – 98% Completed
  • External Finishes – Windows & Sliding doors – 89% Completed, External Plastering – 100% Completed, External Painting – 80% Completed , Louvers/ Façade/ Wall cladding – 75% Completed
  • Mockup – Blockwork, Internal plaster – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – Primer application completed

As per the current work status from our site, we are targeted to complete the following works by the end of JULY 2022.

  • Civil Works – Screeding – 100% to be completed
  • Internal Finishes – Main Door – 100% to be completed, Water Proofing – 100% to be completed, Wall tiling – 100% to be completed, Flooring – 100% to be completed, putty works and painting – 90% to be completed, Handrails – balcony handrail 97% to be completed.
  • Concealed plumbing works – 100% to be completed, Wall and floor services, Risers – 98% to be completed, Centralised Gas Piping System – 60% to be completed
  • Firefighting final fixtures – 100% to be completed
  • External Finishes – Windows & Sliding door- 100% to be completed, External Painting – 85% to be completed, Louvres/ Façade/ Wall cladding – 85% to be completed
  • Mockup – Interior work 100% to be Completed.

Work status as on 09-06-2022, we have completed the following.

  • Structural Works – All sub-structural and structural works- 100% Completed
  • Civil Works – Ceiling plastering and wall plastering- 100% completed, Masonry – Block/ brick- 100% completed, Screeding- 99% Completed
  • Internal Finishes – Main door – (27 fixed out of 33) 95% completed, Waterproofing- 99% Completed, Wall tiling- 97% Completed, Flooring- 95% Completed, putty works & Painting- 85% Completed , Door frame fixtures- 100% Completed, Handrails- Balcony handrail 90% Completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 98% Completed, Wall and floor services,Risers- 95% Completed, Centralised Gas piping system – 40% Completed
  • Final Finishes – Door shutters & ironmongery – 10% Completed, Firefighting final fixtures – 98% Completed
  • External Finishes – Windows & Sliding doors – 85% Completed, External Plastering – 100% Completed, External Painting – 75% Completed , Louvers/ Façade/ Wall cladding – 70% Completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – Primer application completed

As per the current work status from our site, we are targeted to complete the following works by the end of JUNE 2022.

  • Civil Works – Screeding – (2 more apartments) 100% to be completed
  • Internal Finishes – Main Door – 100% to be completed, Water Proofing – 100% to be completed, Wall tiling – (4 more apartments)100% to be completed, Flooring – (2 more apartments)100% to be completed, putty works (2 more apartments and 2nd floor amenity to be completed) and painting – 90% to be completed, Handrails – balcony handrail 97% to be completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 100% to be completed, Wall and floor services, Risers – 98% to be completed, Centralised Gas Piping System – 50% to be completed
  • Final Finishes – Door shutters & ironmongery – 20% Completed, Firefighting final fixtures – 100% to be completed
  • External Finishes – Windows & Sliding door- 100% to be completed, External Painting – 80% to be completed , Louvres/ Façade/ Wall cladding – 80% to be completed
  • Mockup – Interior work 100% to be Completed.

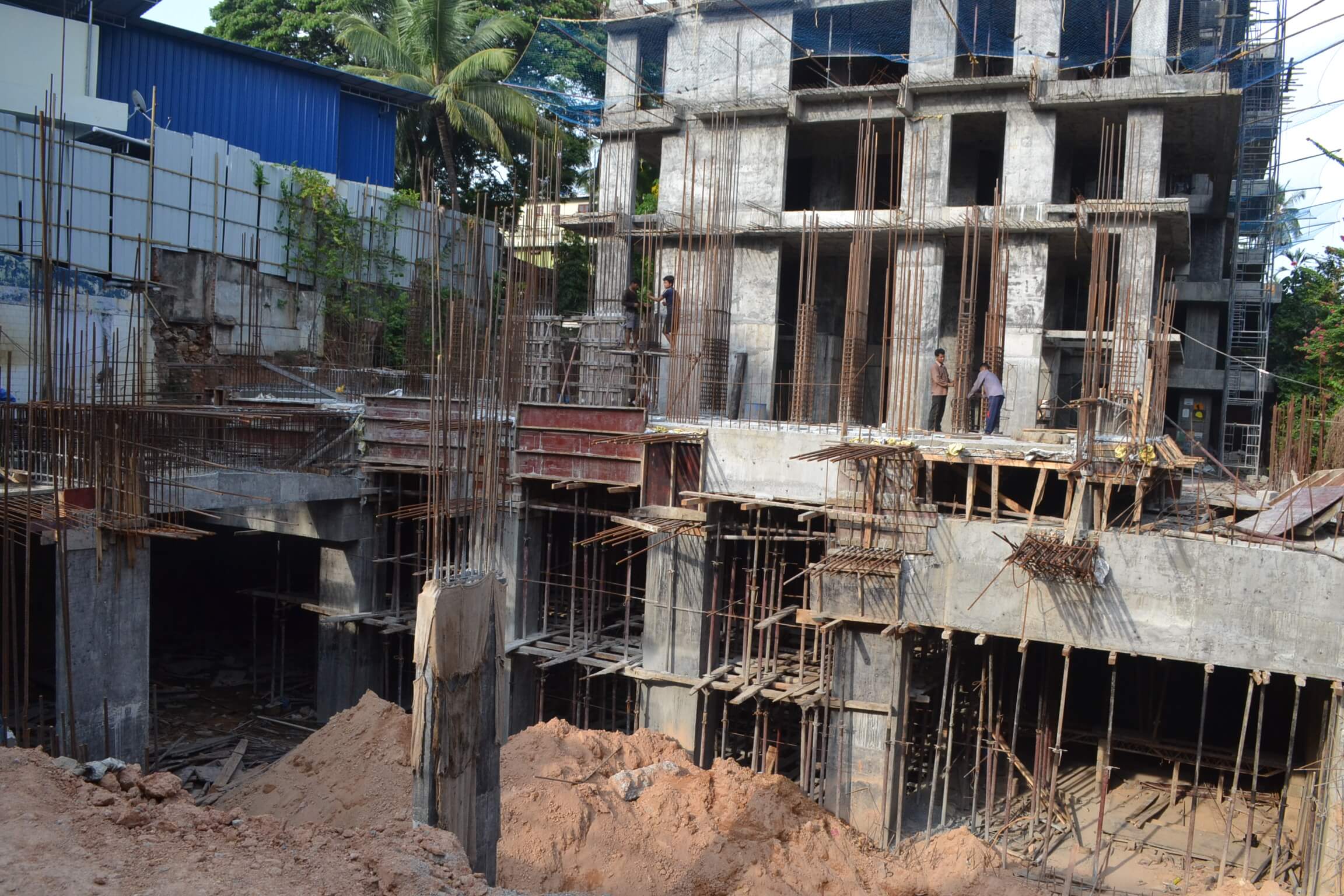

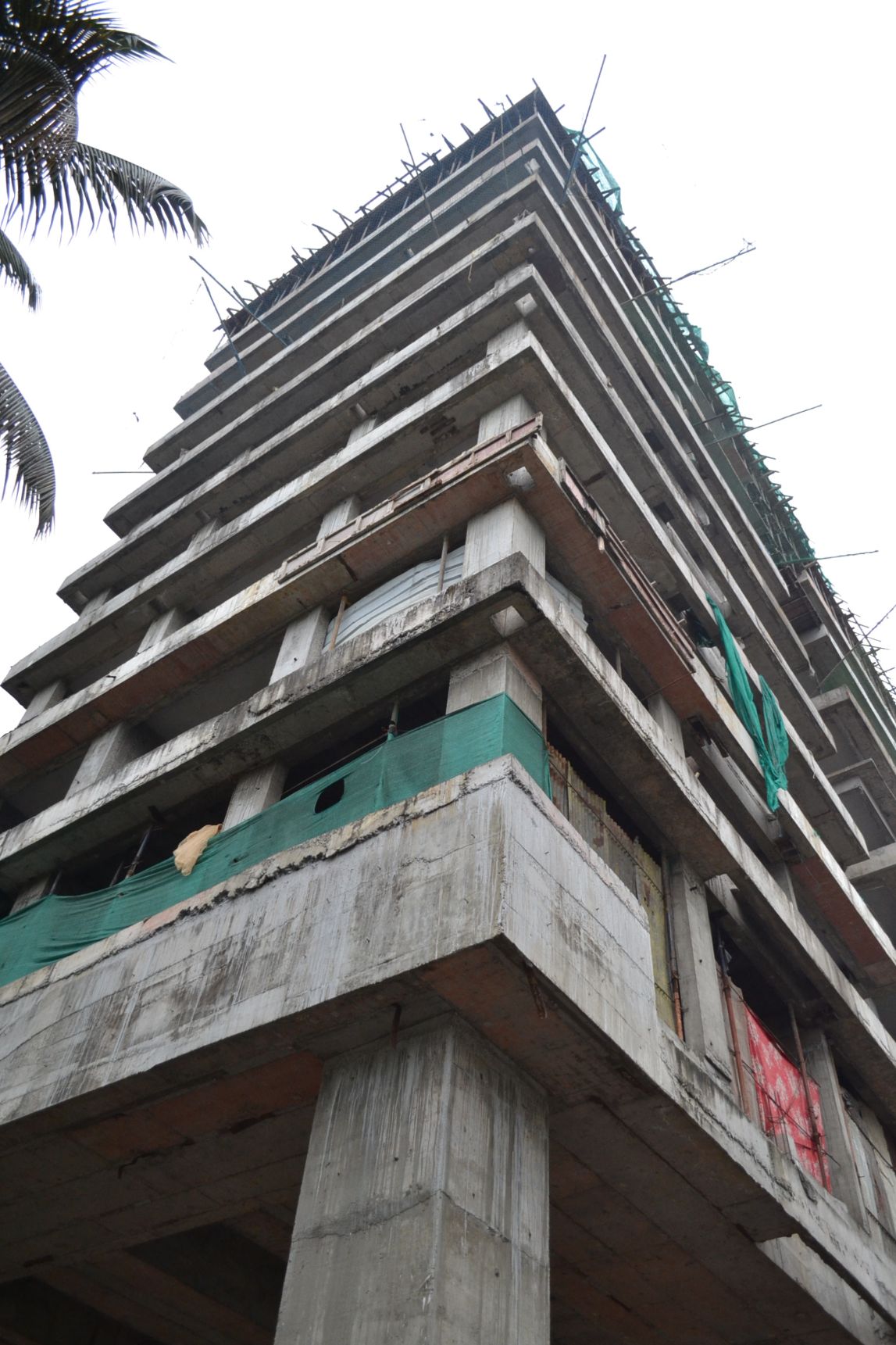

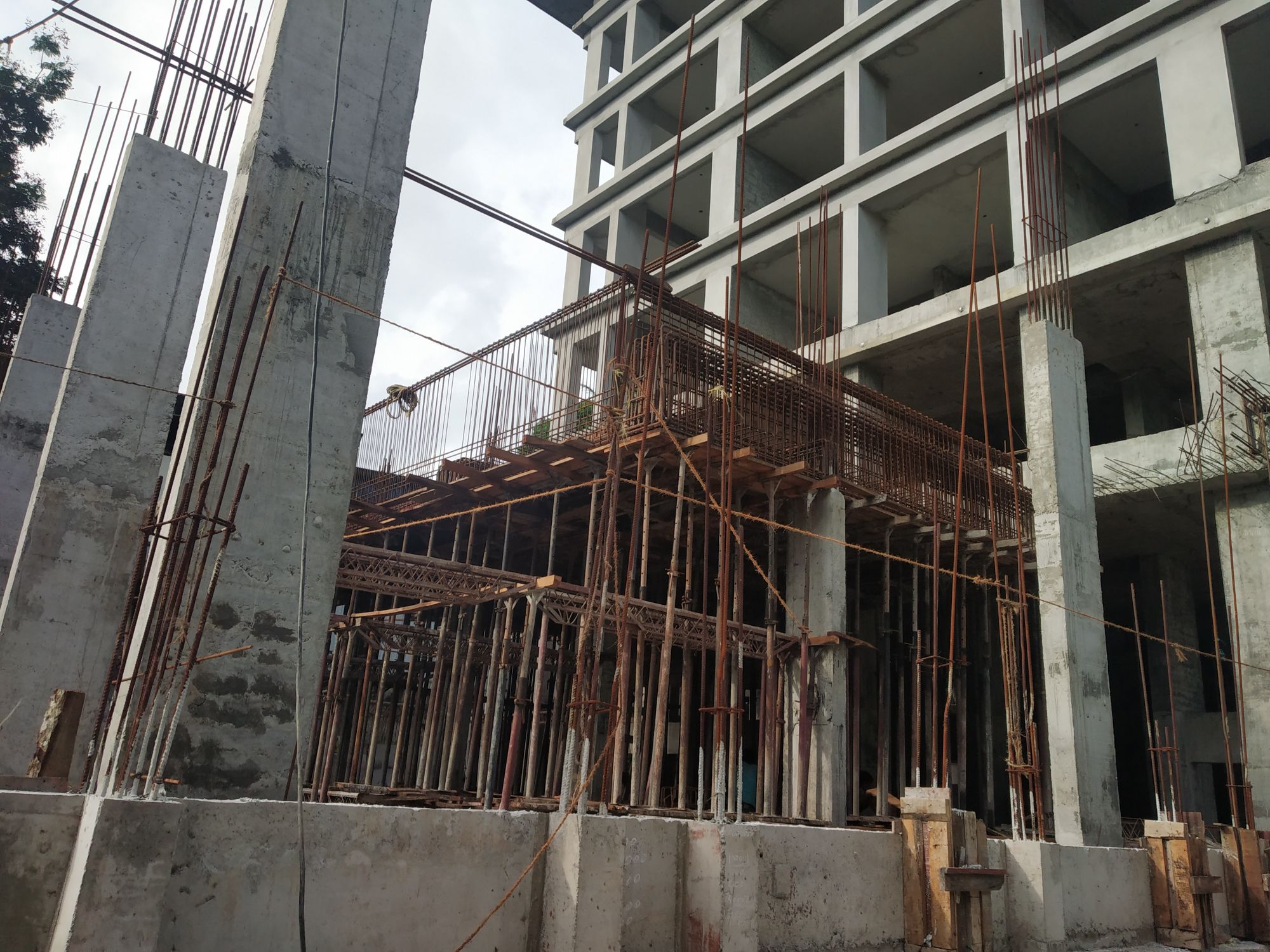

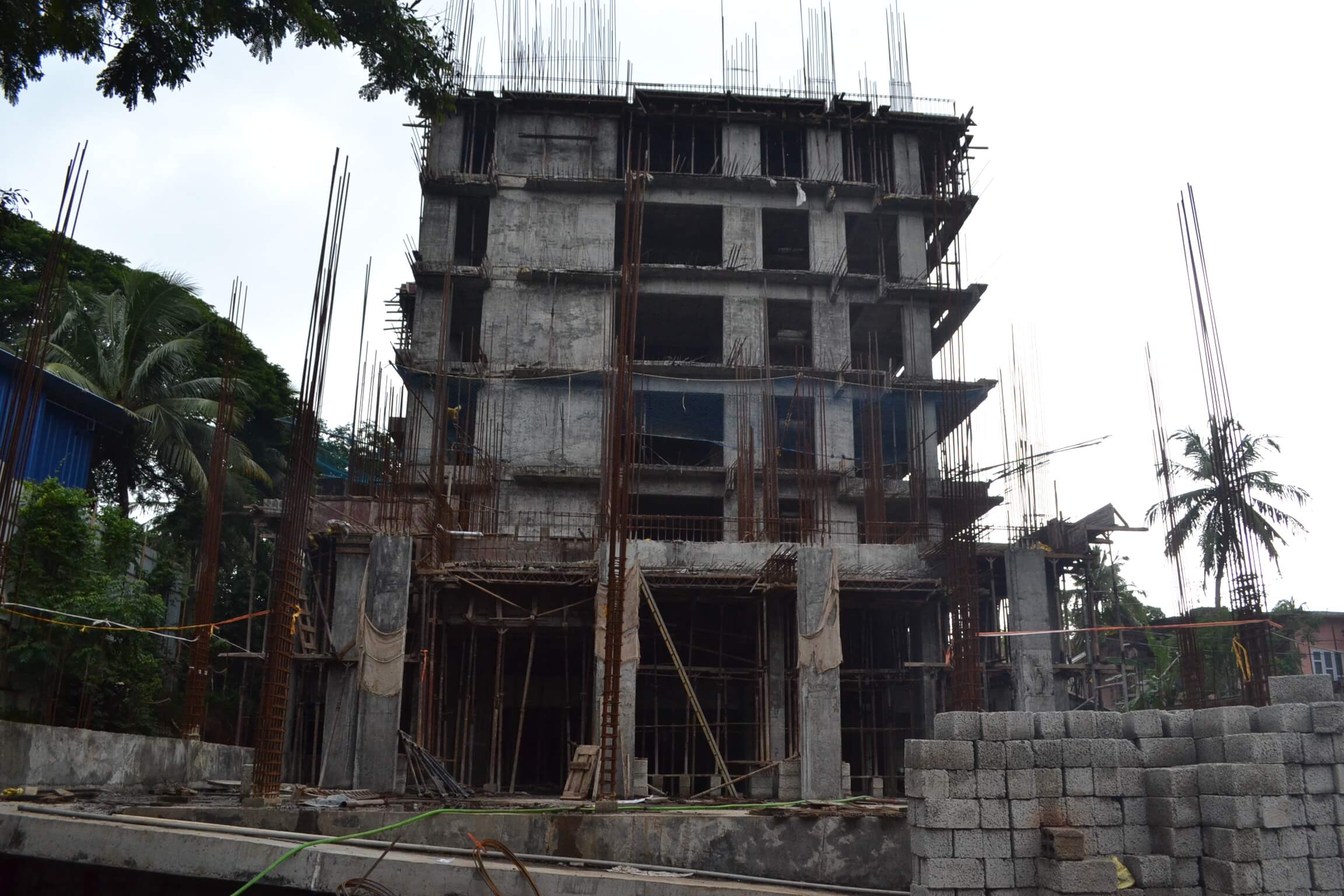

Work status as on 12-04-2022, we have completed the following.

  • Structural Works – All sub-structural and structural works- 100% Completed
  • Civil Works – Ceiling plastering and wall plastering- up to 19th floor completed (98%), Masonry – Block/ brick- 100% completed, Screeding- 93% Completed, Internal plaster – up to 19 th floor completed (98%)
  • Internal Finishes – Main door – up to 17th floor completed (22 fixed out of 33), Waterproofing- 90% Completed, Wall tiling- 90% Completed, Flooring- 90% Completed, putty works & Painting- 75% Completed, Door frame fixtures- 100% Completed, Handrails- Balcony handrail 65% Completed.
  • Electrical, Plumbing & Firefighting works – CConcealed plumbing works – 90% Completed, Wall and floor services,Risers- 90% Completed, Centralised Gas piping system – 25% Completed
  • Final Finishes – Door shutters & ironmongery – 7% Completed, Firefighting final fixtures – 95% Completed
  • External Finishes – Windows & Sliding doors – 70% Completed, External Plastering – 100% Completed, External Painting – 60% Completed (1st coat putty – 90% completed) , Louvres/ Façade/ Wall cladding – 45% Completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – Primer application completed

As per the current work status from our site, we are targeted to complete the following works by the end of APRIL 2022.

  • Civil Works – ceiling plastering and wall plastering – 100% to be completed, Screeding – (6 more flats to be completed) 95% to be completed, Internal Plaster – 100% to be completed.
  • Internal Finishes – Main Door – 18th, 19th floor 100% to be completed, Water Proofing – 95% to be completed, Wall tiling – (7 more flats to be completed) 100% to be completed, Flooring – (6 more flats to be completed) 95% to be completed, putty works and painting -85% to be completed (2nd floor, amenity fire stair portions remaining – putty works, inside 1st coat emulsion – 3 flats remaining), Handrails – 75% to be completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 95% to be completed, Wall and floor services, Risers – 95% to be completed, Centralised Gas Piping System – 35% to be completed.
  • Final Finishes – Firefighting final fixtures – 100% to be completed
  • External Finishes – Windows & Sliding door- 80% to be completed, External Painting – 70% to be completed, Louvres/ Façade/ Wall cladding – 55% to be completed
  • Mockup – Interior work 100% to be Completed.

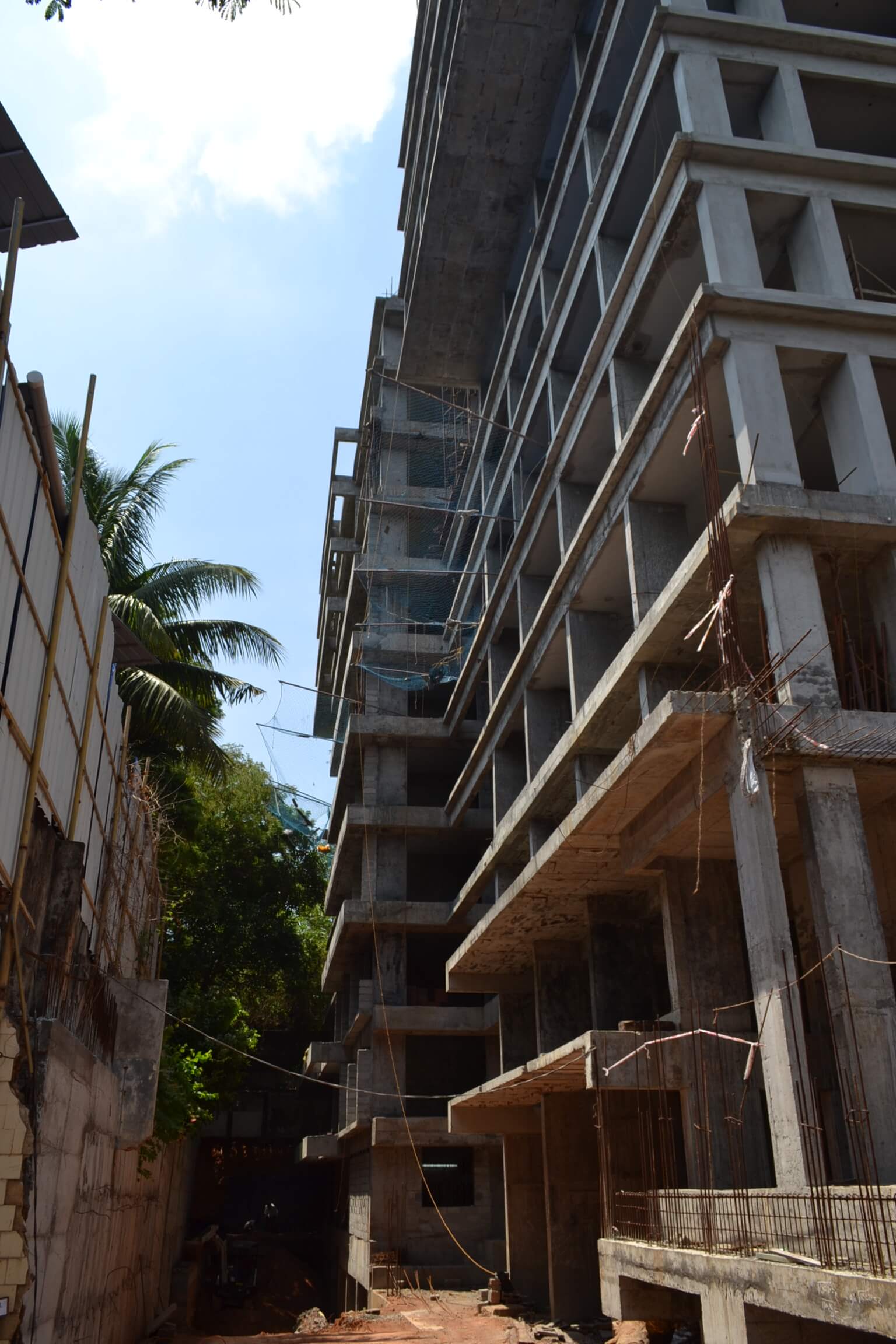

Work status as on 10-03-2022, we have completed the following.

  • Structural Works – All sub-structural and structural works- 100% Completed
  • Civil Works – Ceiling plastering and wall plastering- 98% Completed, Masonry – Block/ brick- 100% completed, Screeding- 92% Completed, Internal plaster – 98% Completed
  • Internal Finishes – Main door – 11th,14th,16th floor completed. Waterproofing- 90% Completed, Wall tiling- 85% Completed, Flooring- 85% Completed, putty works & Painting- 70% Completed, Door frame fixtures- 100% Completed, Handrails- Balcony handrail 45% Completed.
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 90% Completed, Wall and floor services, Risers- 90% Completed, Centralised Gas piping system – 15% Completed
  • Final Finishes – Door shutters & ironmongery – 5% Completed, Firefighting final fixtures – 80% Completed
  • External Finishes – Windows & Sliding doors – 70% Completed, External Plastering – 100% Completed, External Painting – 50% Completed, Louvres/ Façade/ Wall cladding – 40% Completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – ongoing, Reticulated gas piping – 100% completed, Painting – Primer application completed

As per the current work status from our site, we are targeted to complete the following works by the end of MARCH 2022.

  • Civil Works – ceiling plastering and wall plastering – 100% to be completed, Internal Plaster – 100% to be completed.
  • Internal Finishes – Main Door – 70% to be completed, Water Proofing – 95% to be completed, Wall tiling – 90% to be completed, Flooring – 90% to be completed, putty works and painting -75% to be completed, Door frame fixtures – 100% to be completed, Handrails – 75% to be completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 95% to be completed, Corridor handrail works – 10% to be completed, Wall and floor services, Risers – 95% to be completed, Centralised Gas Piping System – 20% to be completed
  • Final Finishes – Door shutters & ironmongery – 5% to be completed, Firefighting final fixtures – 90% to be completed
  • External Finishes – Windows & Sliding door- 80% to be completed, External Painting – 60% to be completed, Louvres/ Façade/ Wall cladding – 50% to be completed
  • Mockup – Interior work 100% to be Completed.

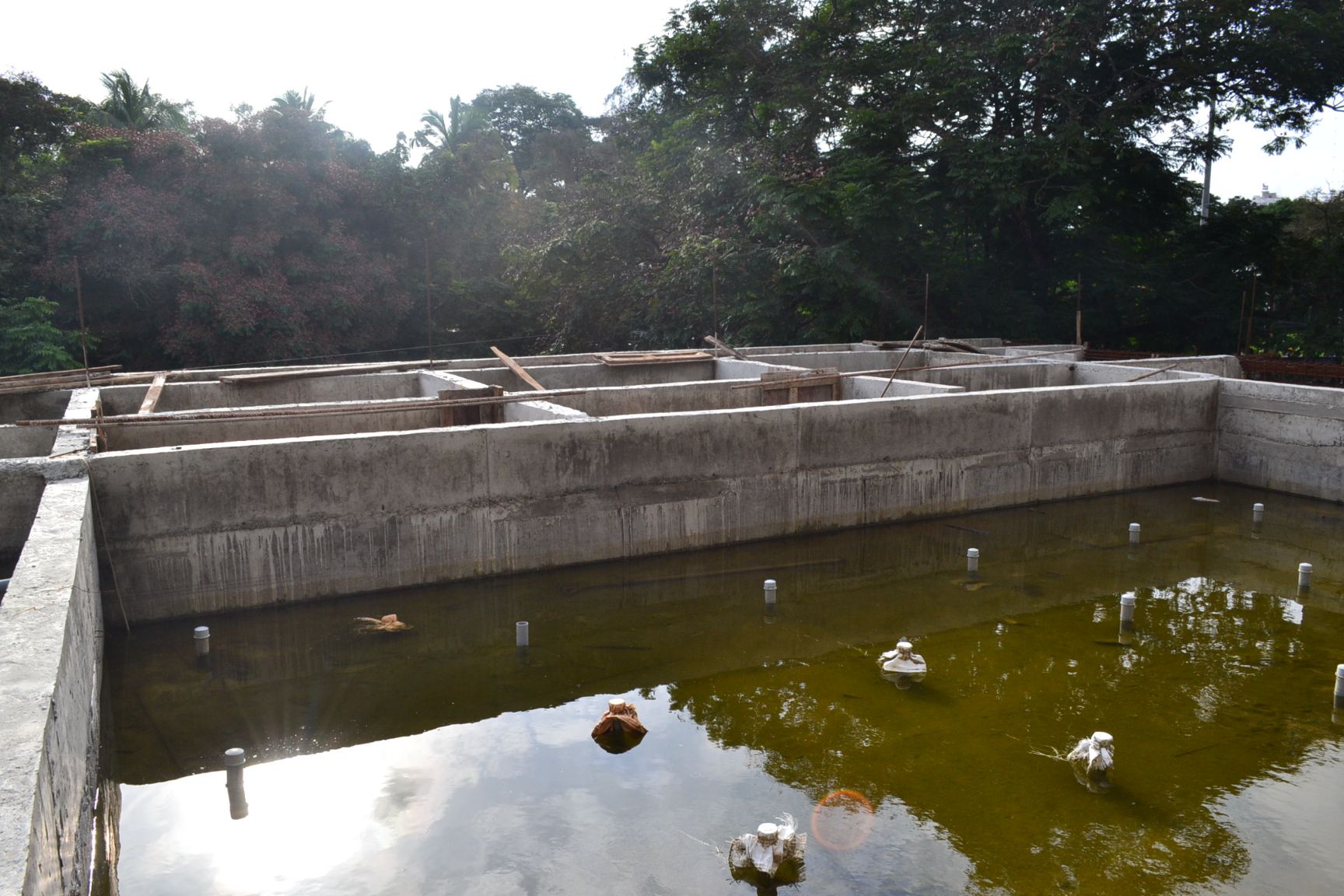

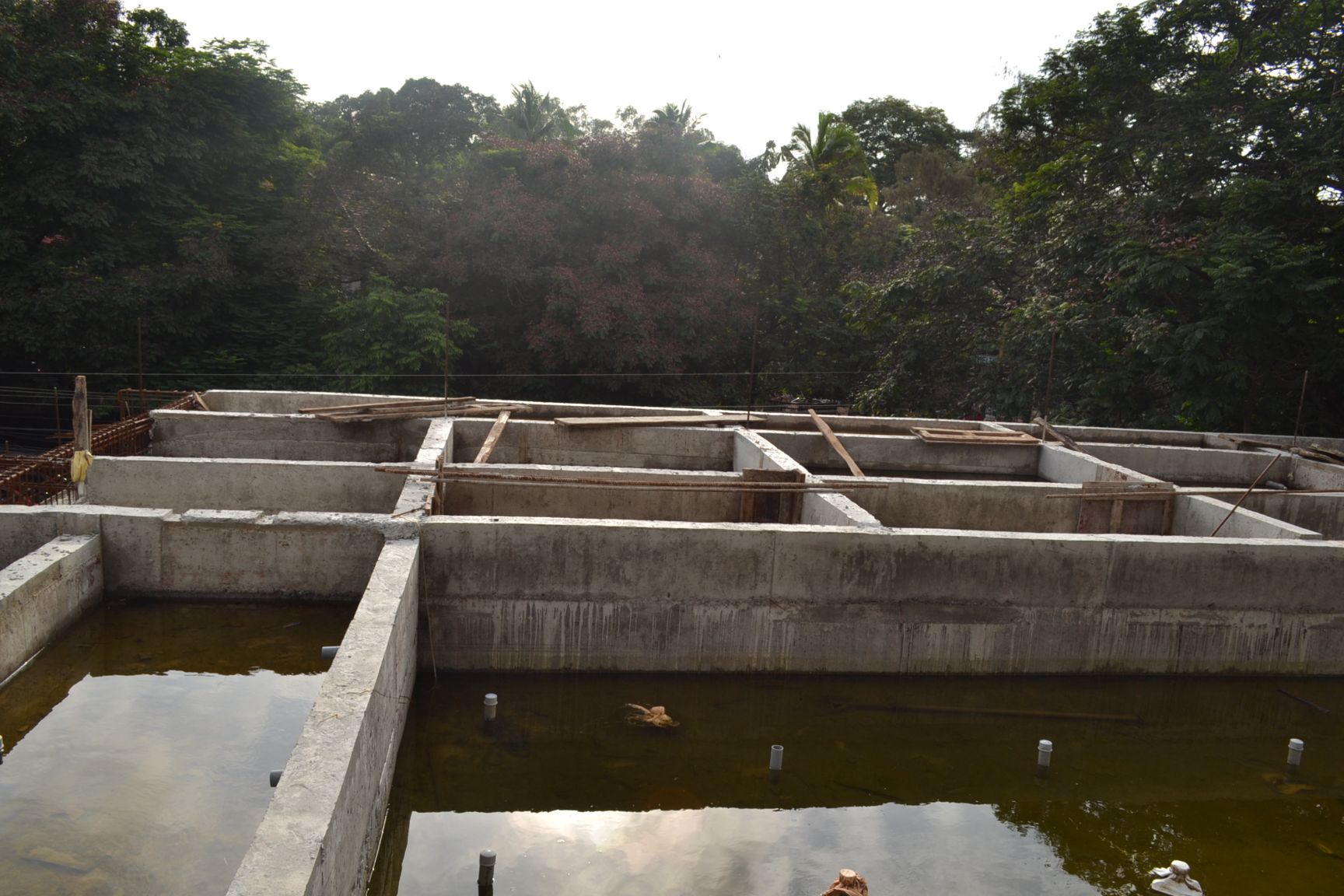

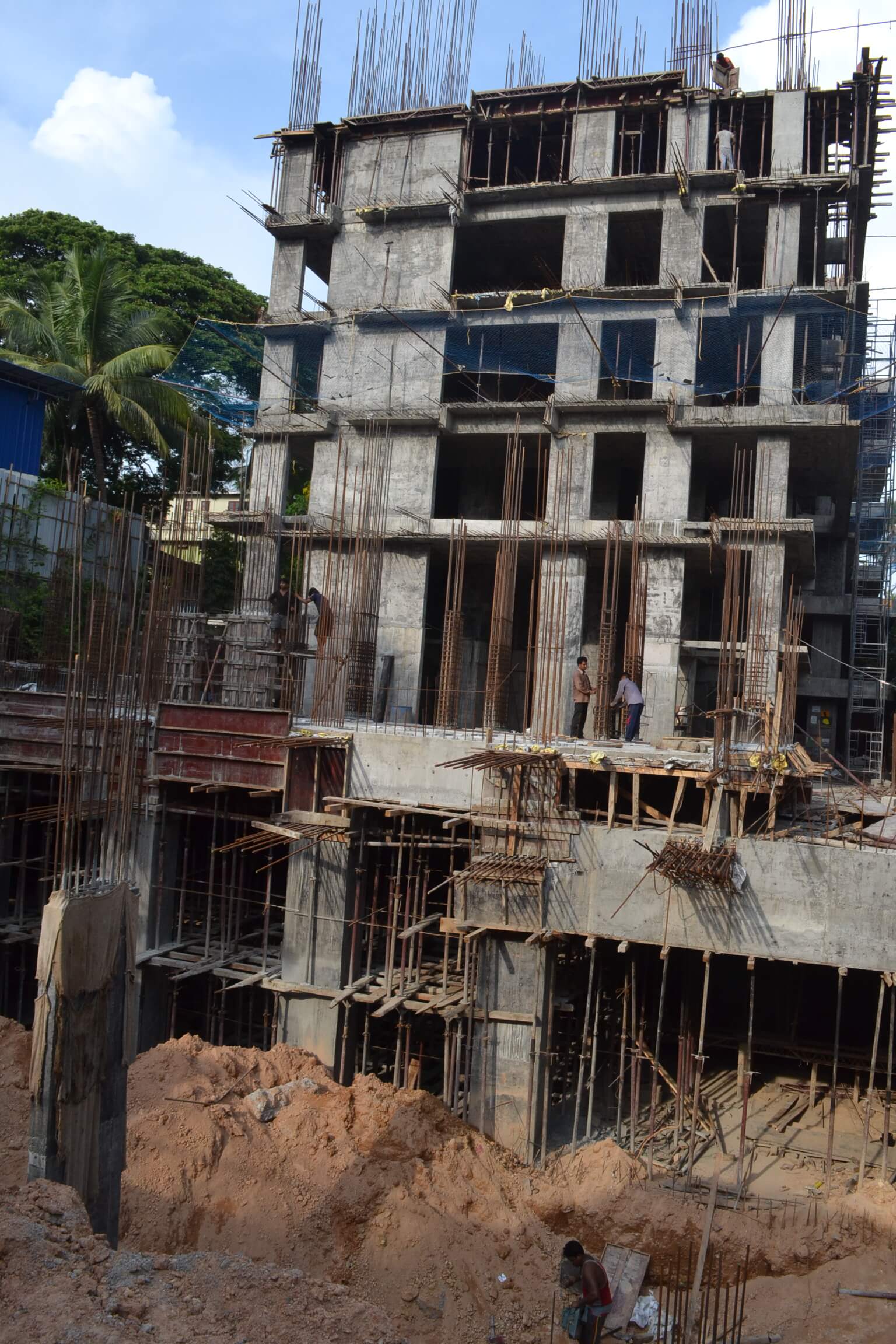

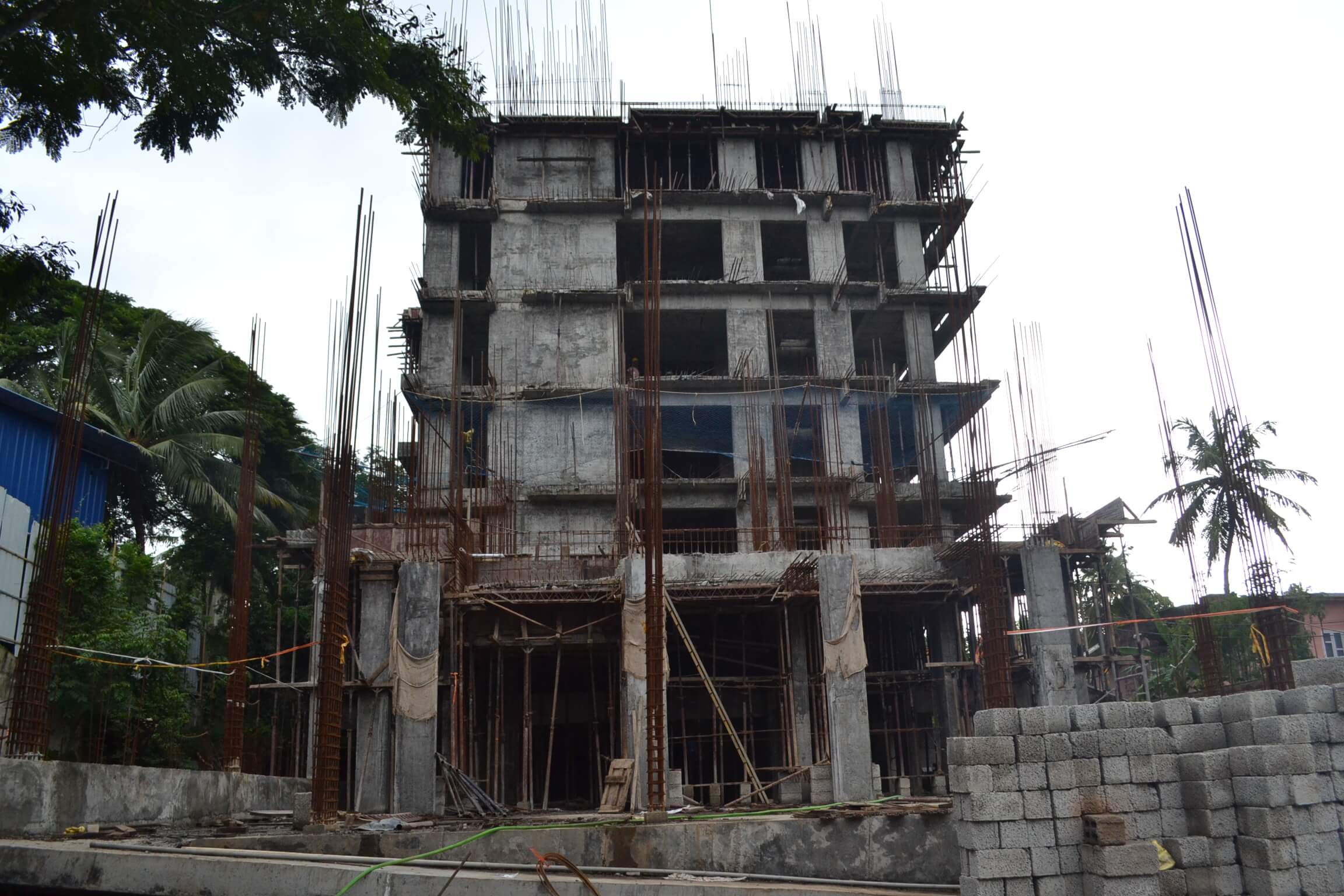

Work status as on 09-04-2021, we have completed the following.

  • RCC – Structure completed
  • Block work -completed-
  • Ceiling Plastering work -completed
  • Retaining wall -100% completed
  • LT Electrical work – upto 10 th floor (100% completed),-12th floor-19th floor-100% completed,11th floor- 25% completed .

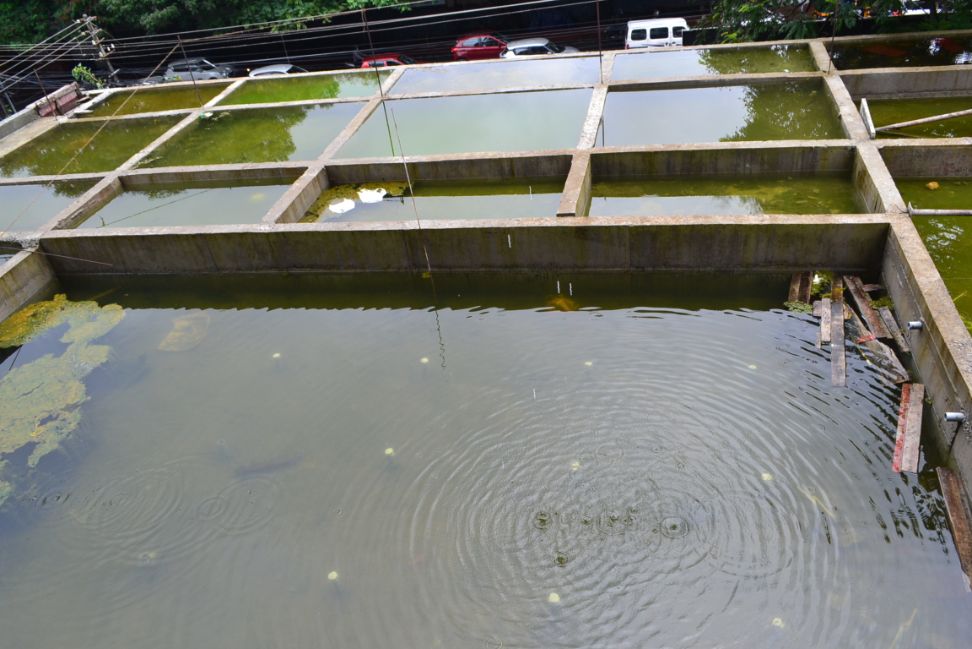

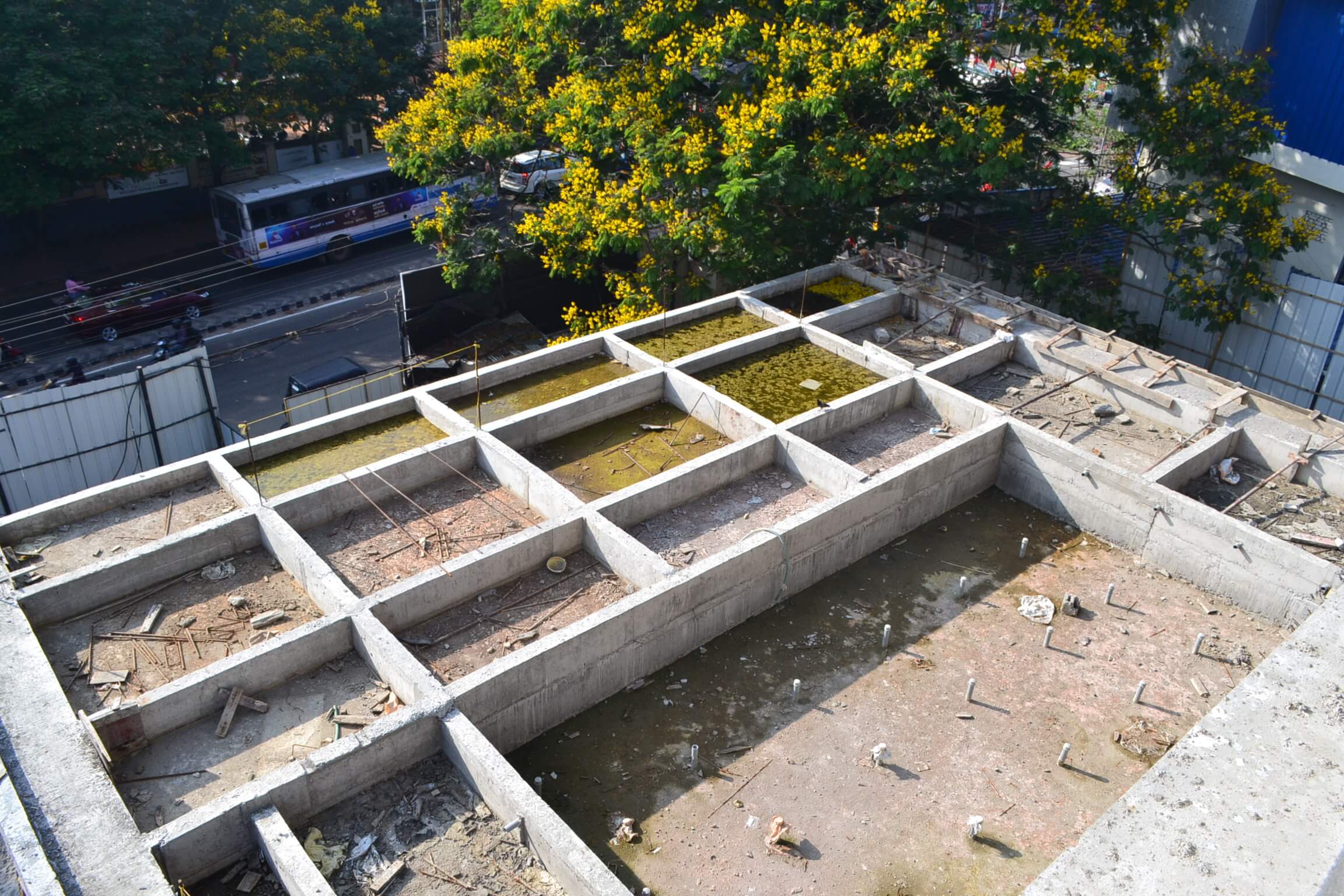

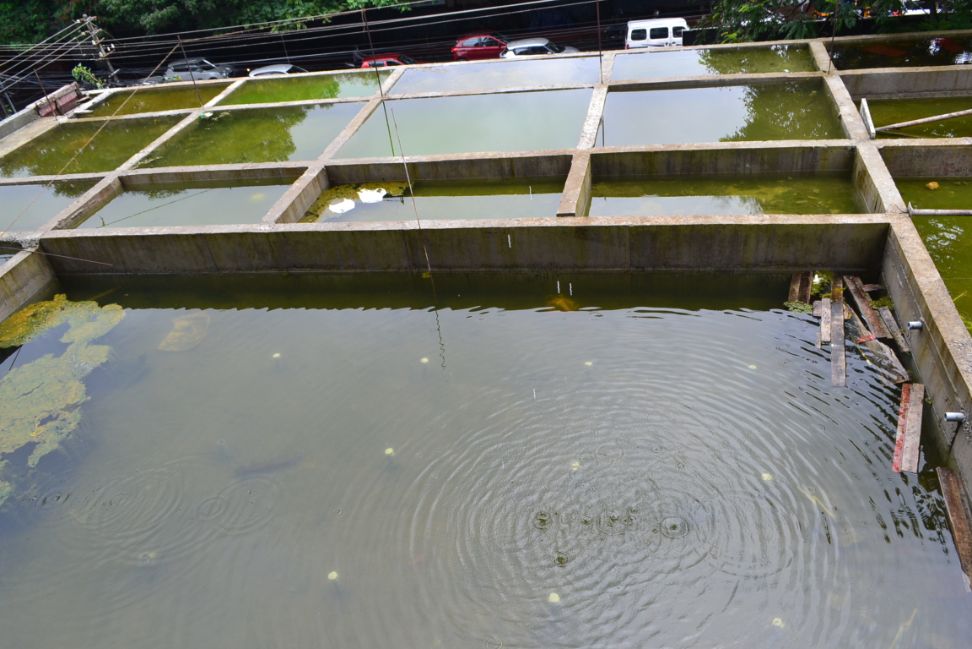

  • Water Proofing toilet Work : upto 19th floor-100% completed
  • Water Proofing balcony Work : upto 19th floor-100% completed.
  • External Plastering- (Frond portion,Rear Portion,left)-100% completed,(Left side)-100% completed, (Right side) – 80% completed
  • Plumbing balcony Work:- upto 19th floor:-100%completed.
  • Tiling Work: -Mock up flat-85% completed.

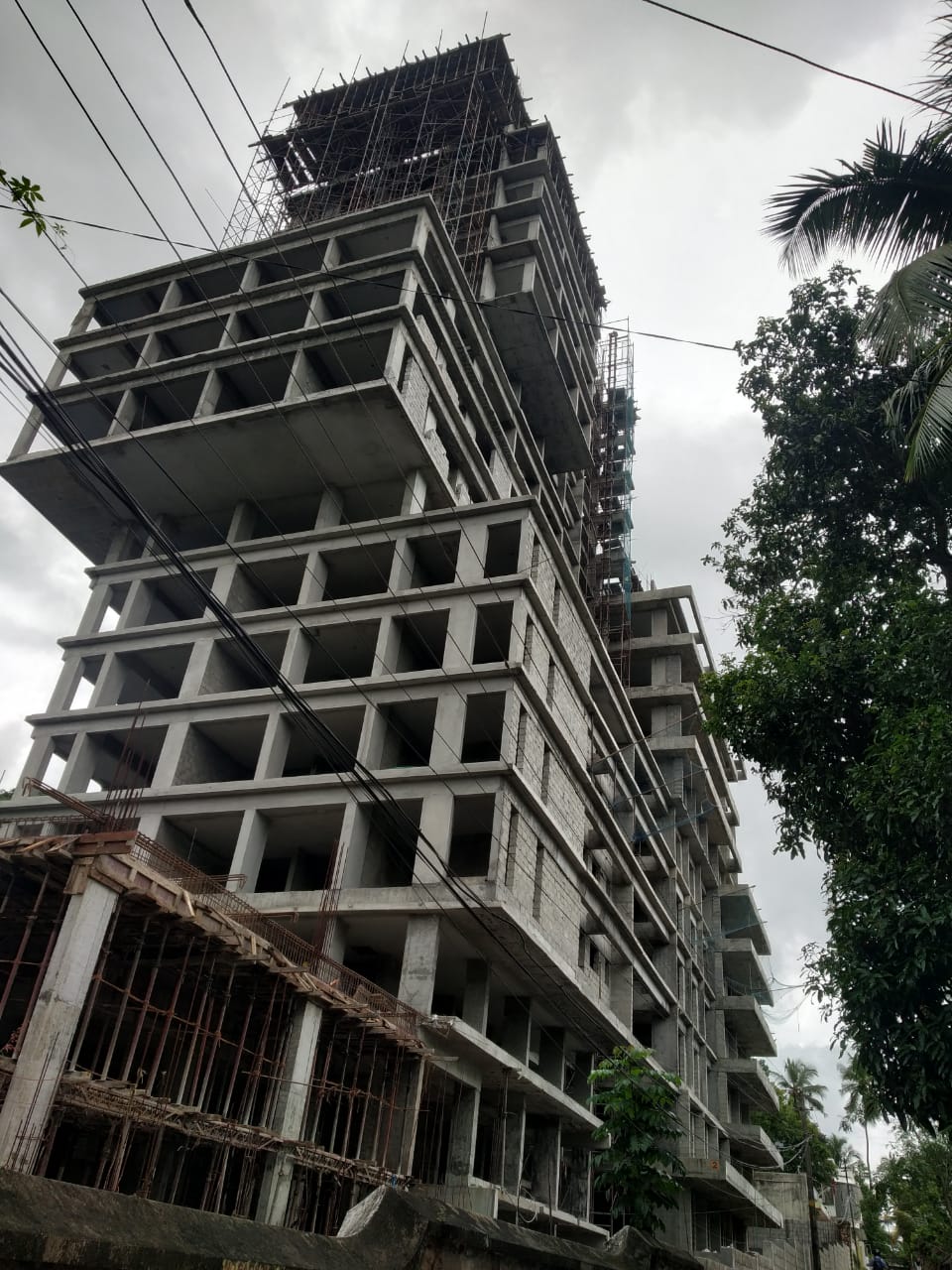

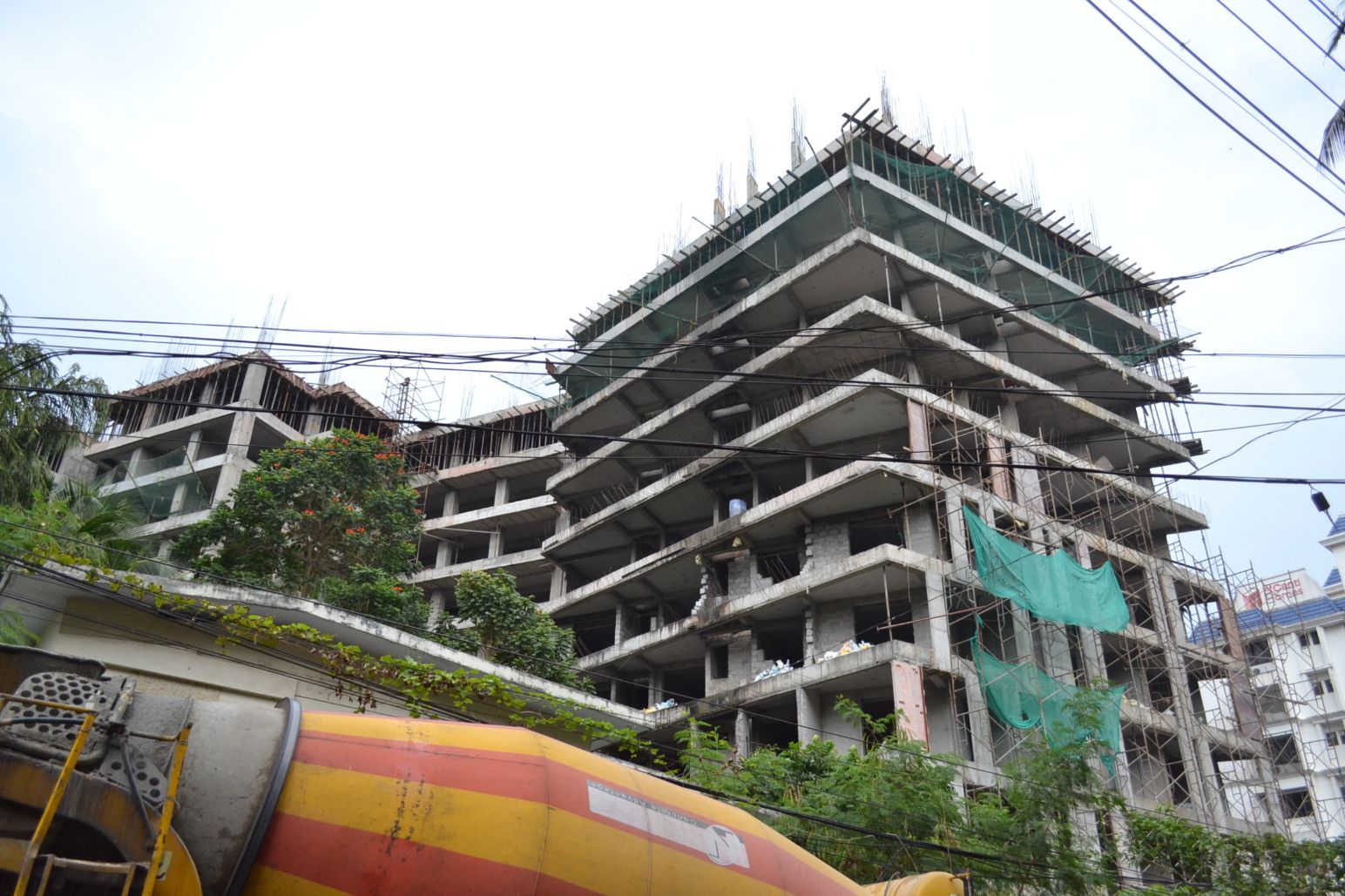

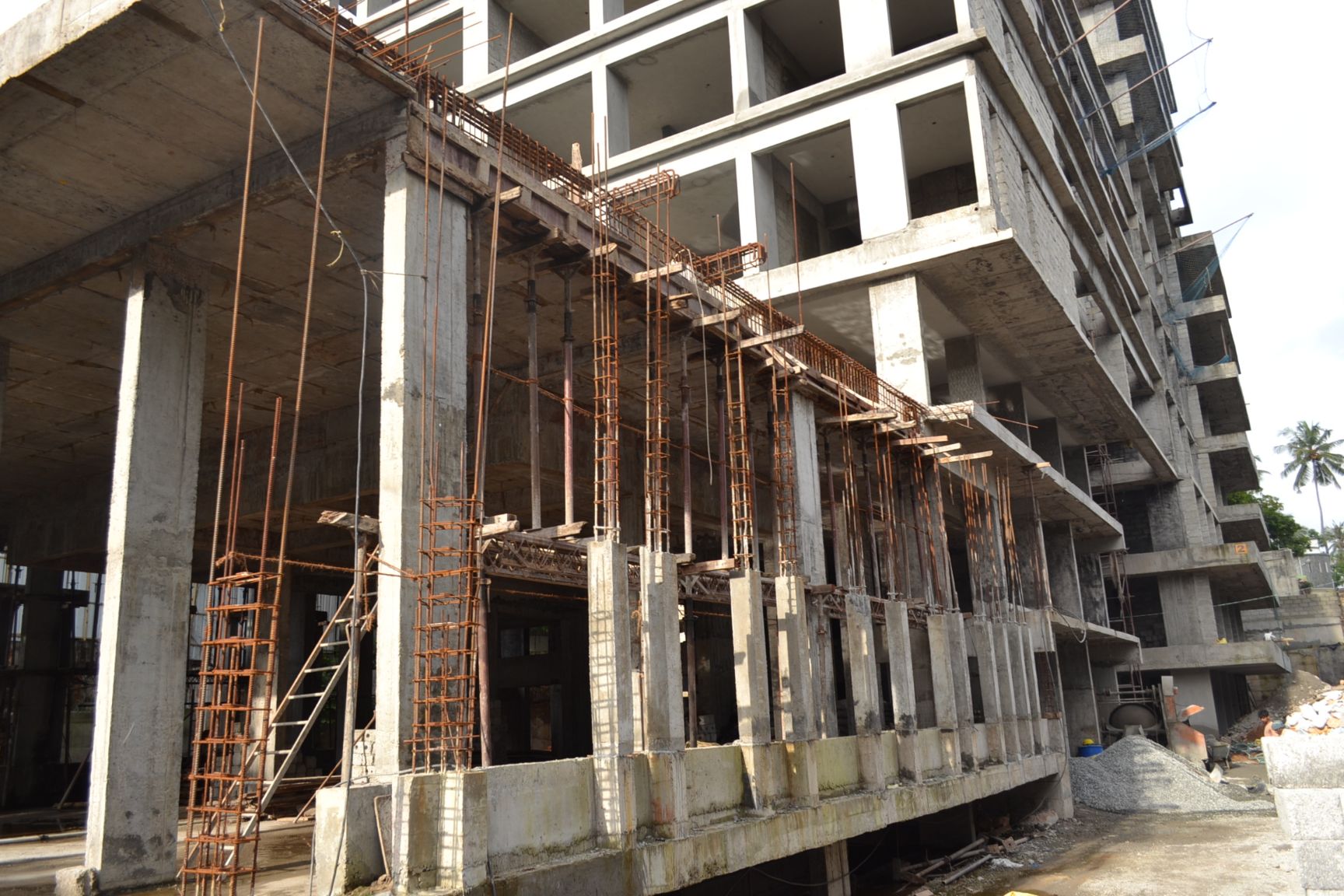

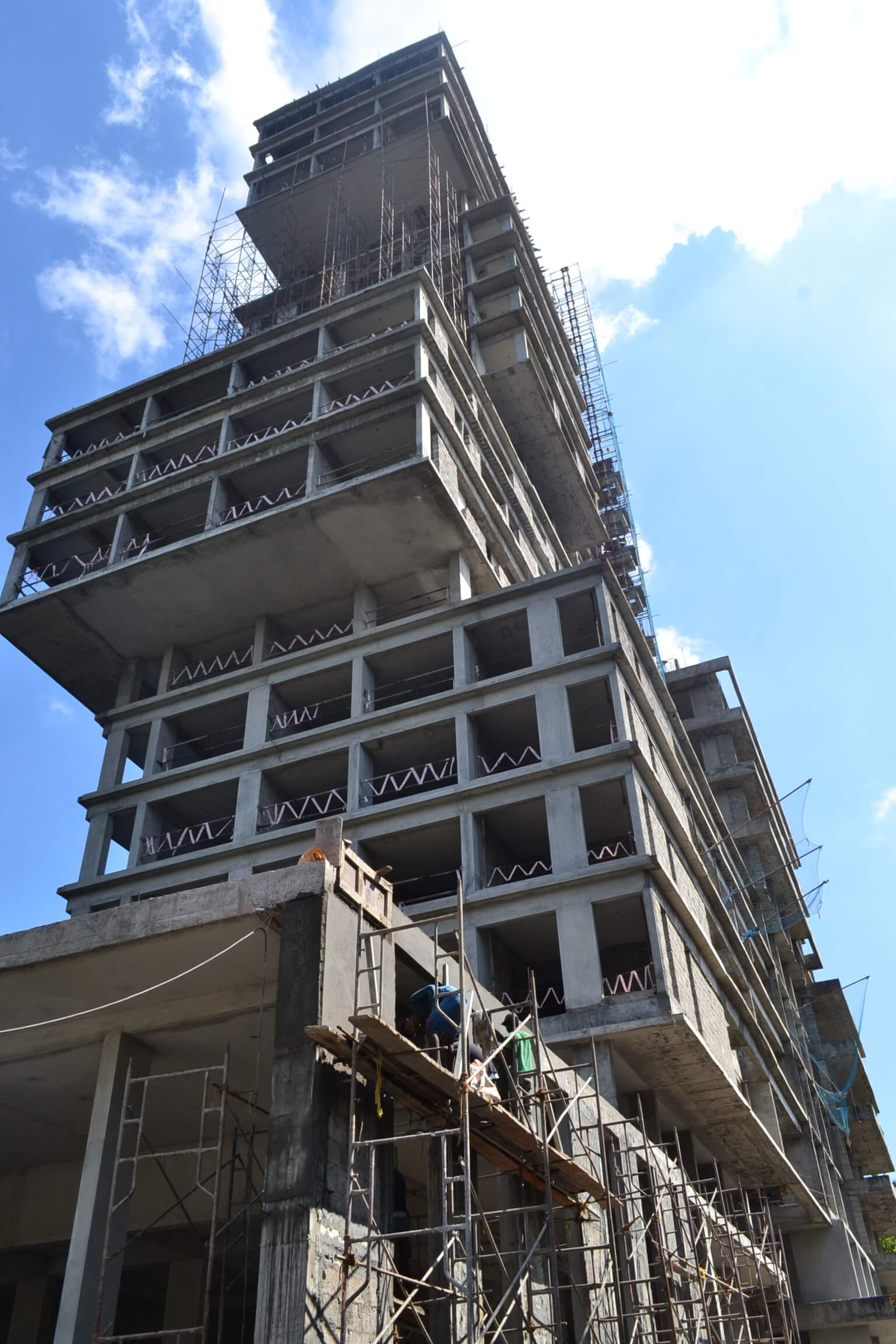

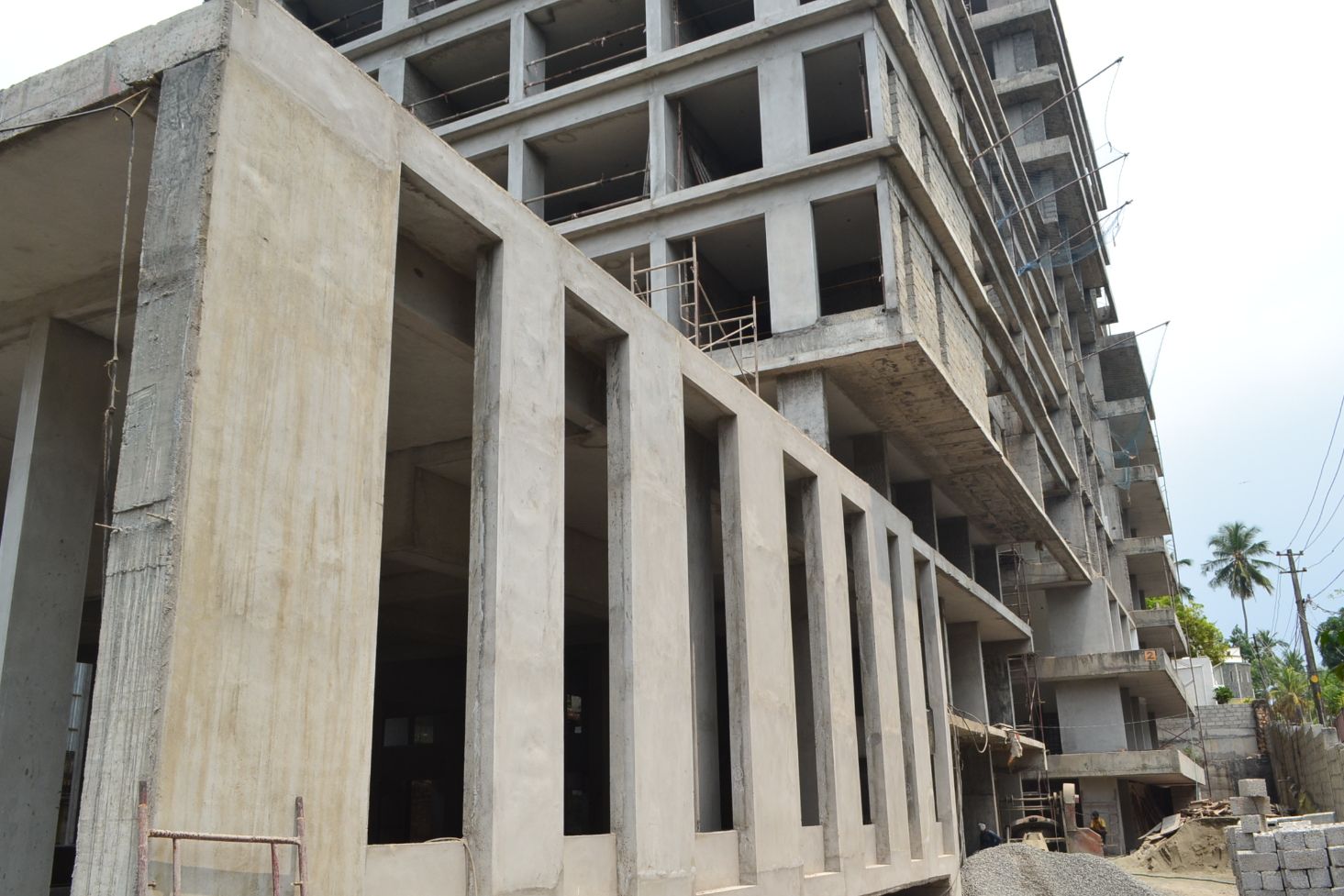

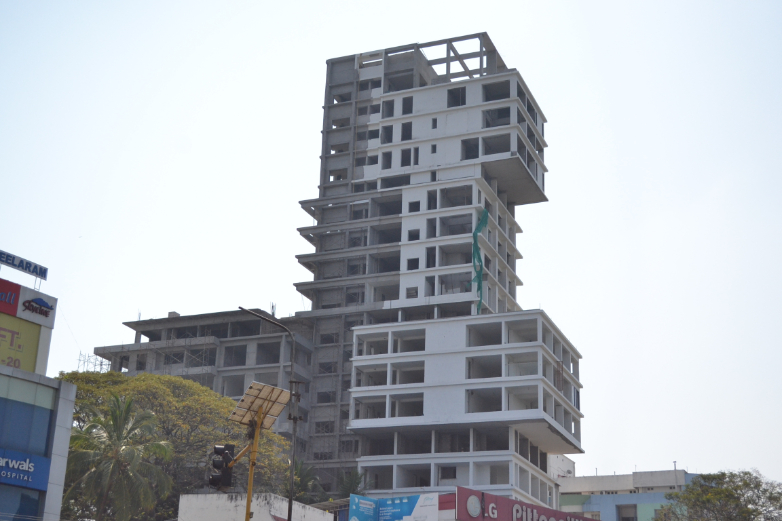

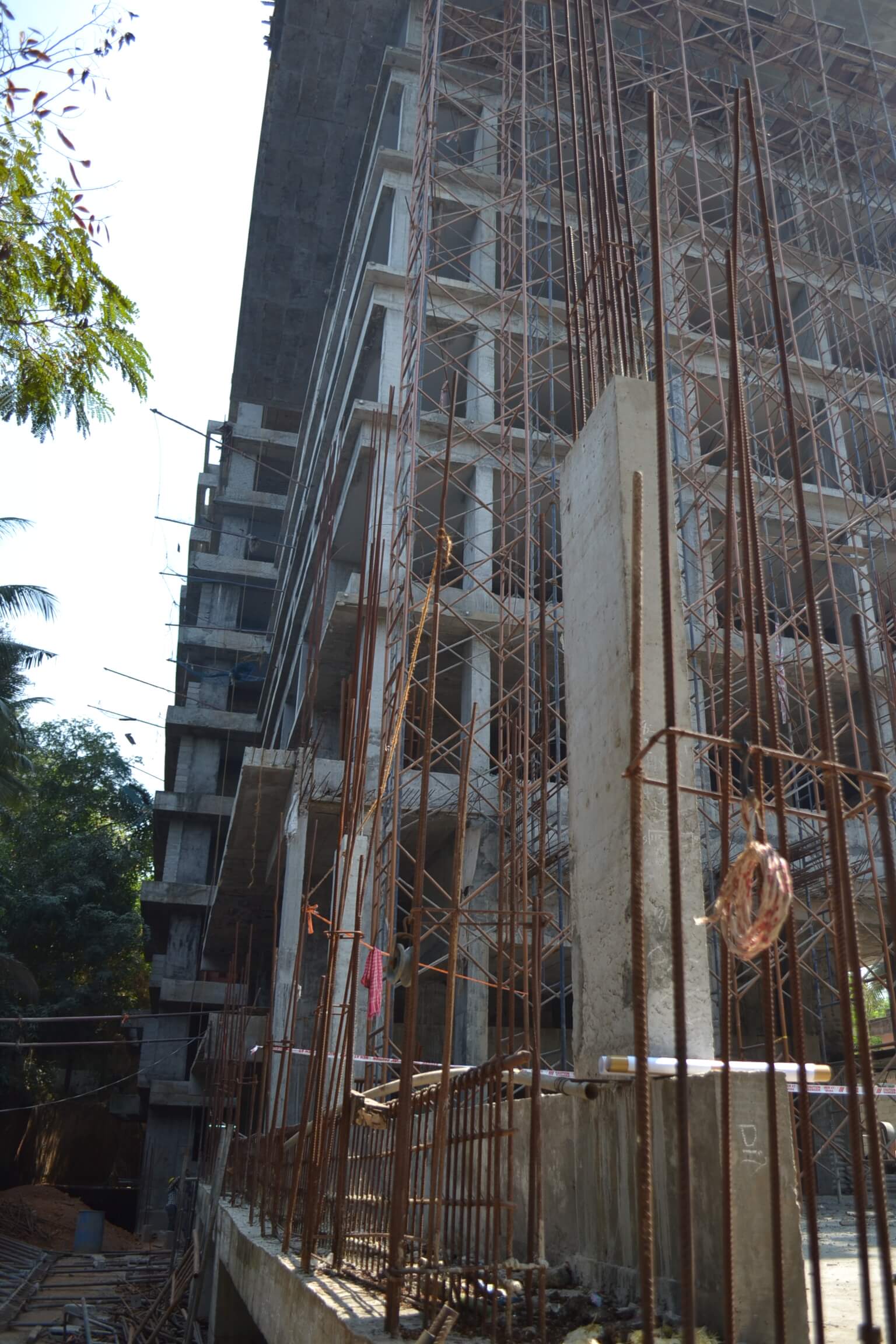

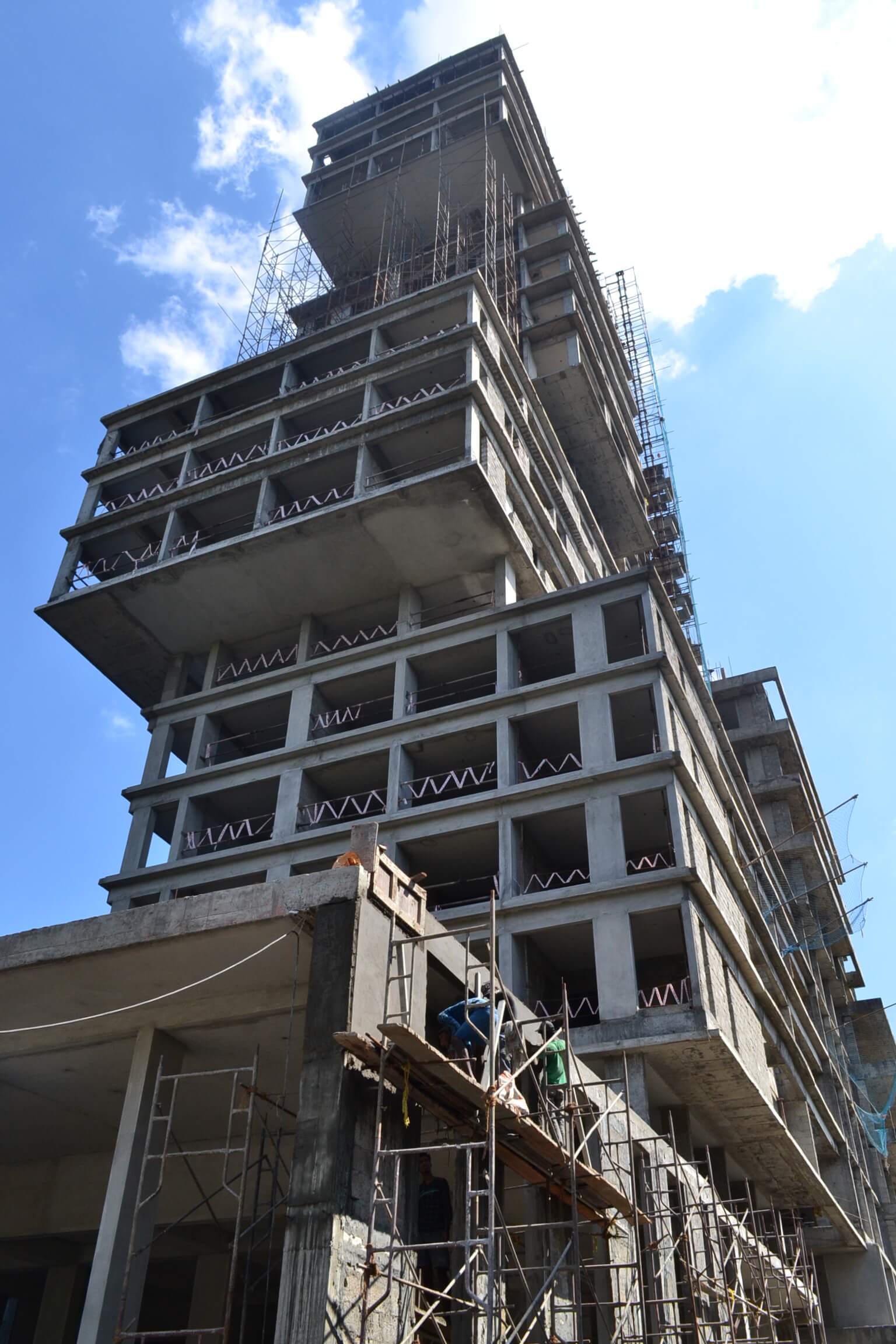

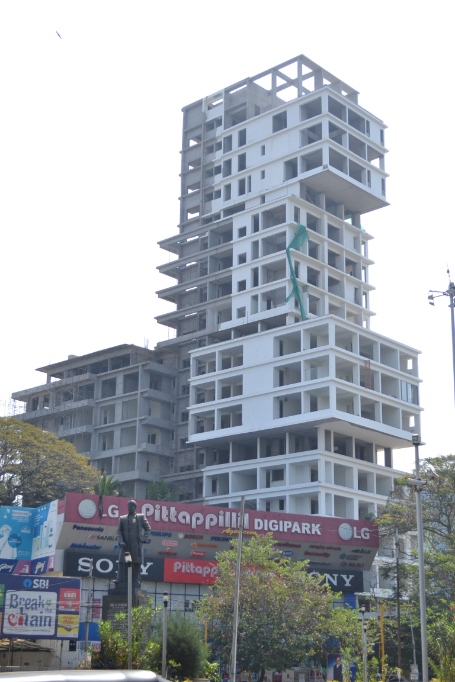

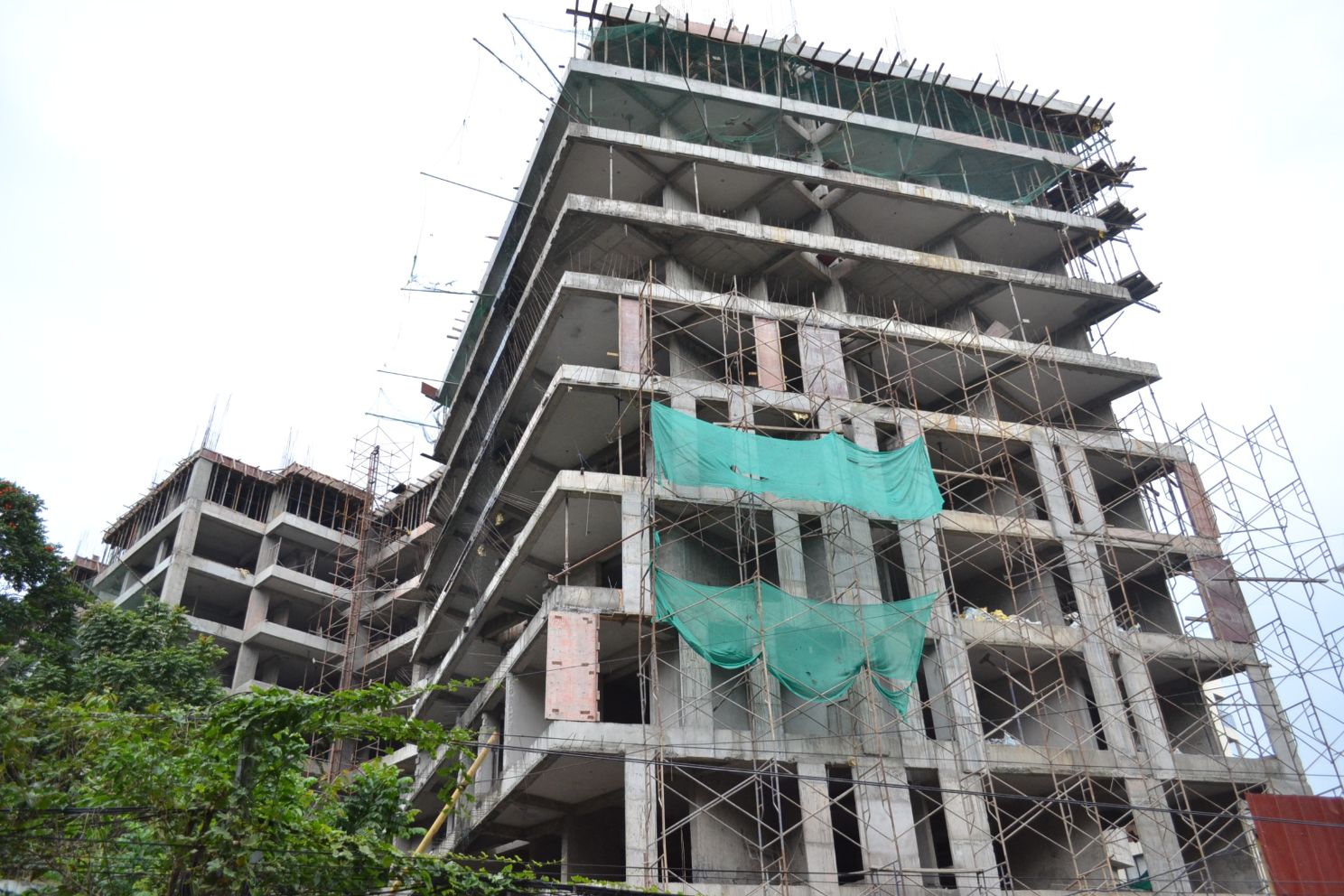

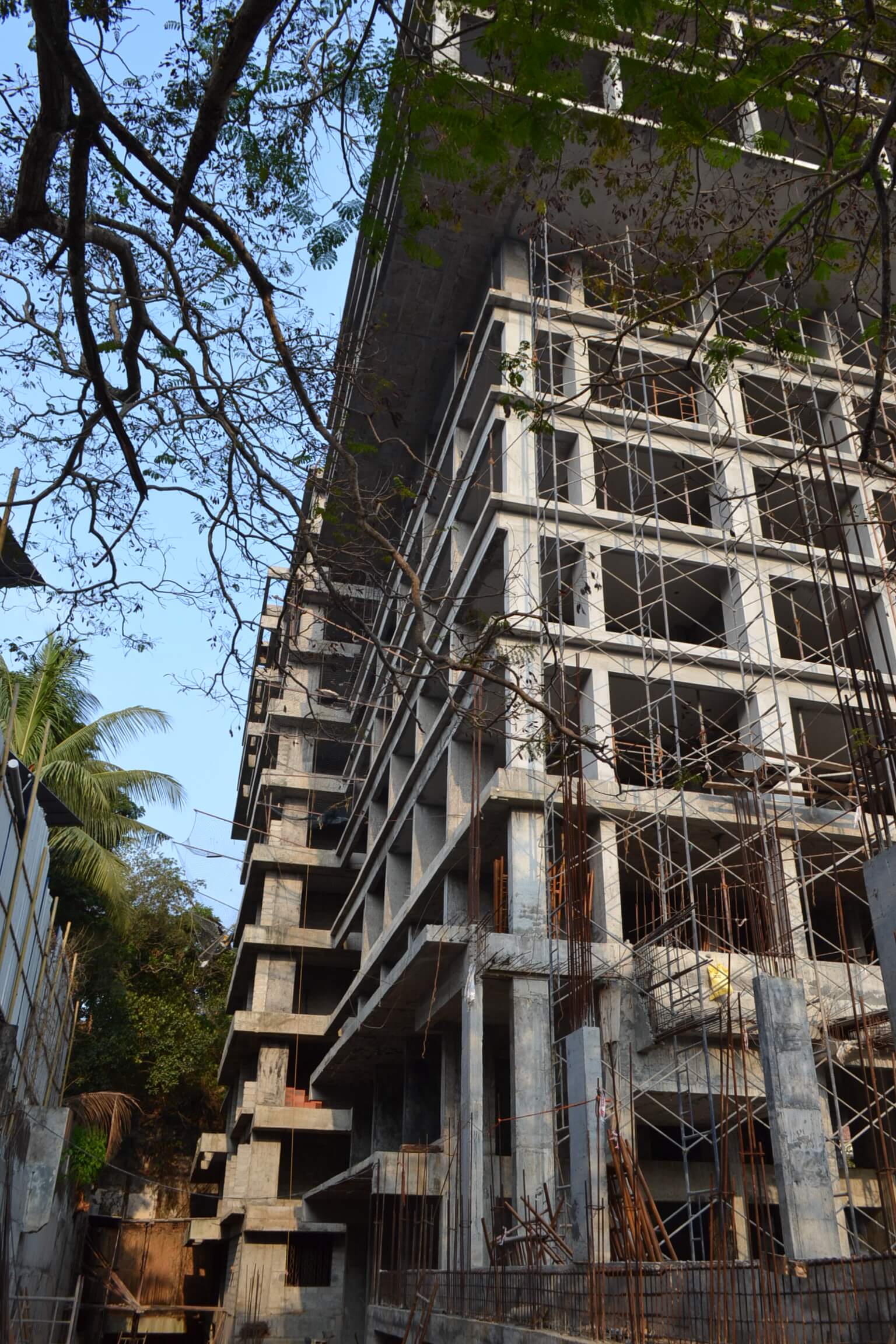

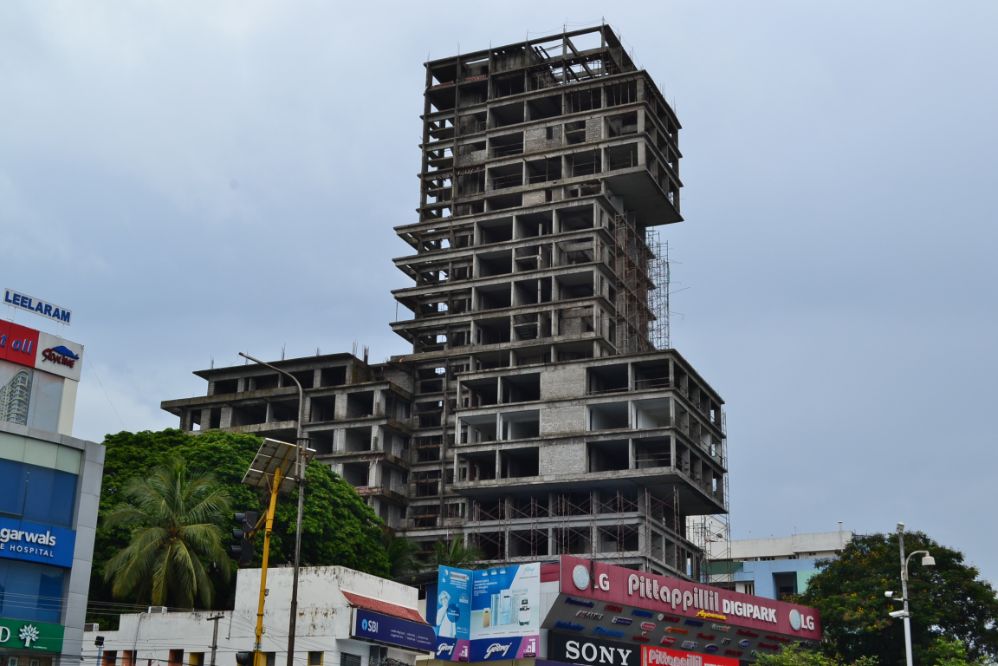

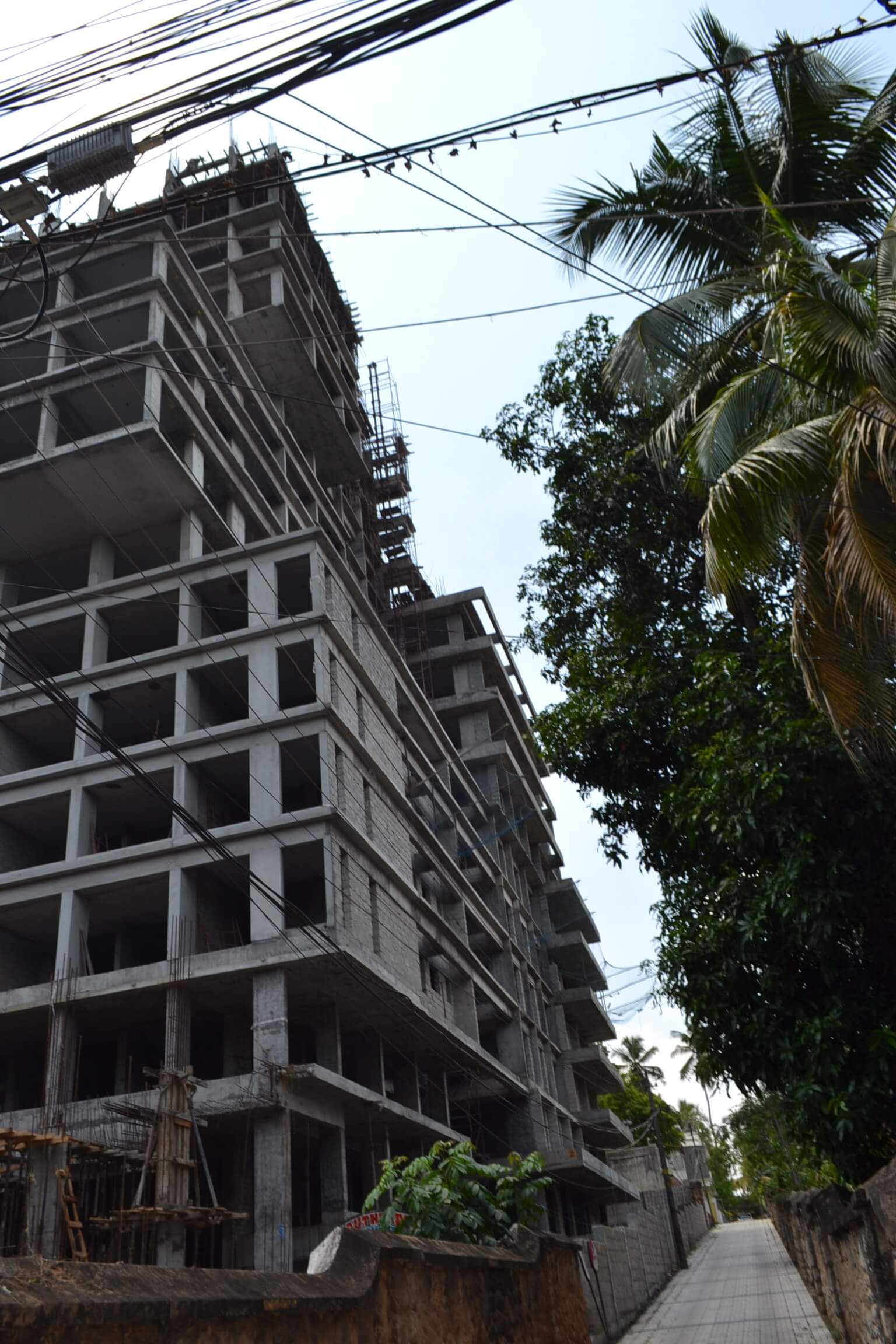

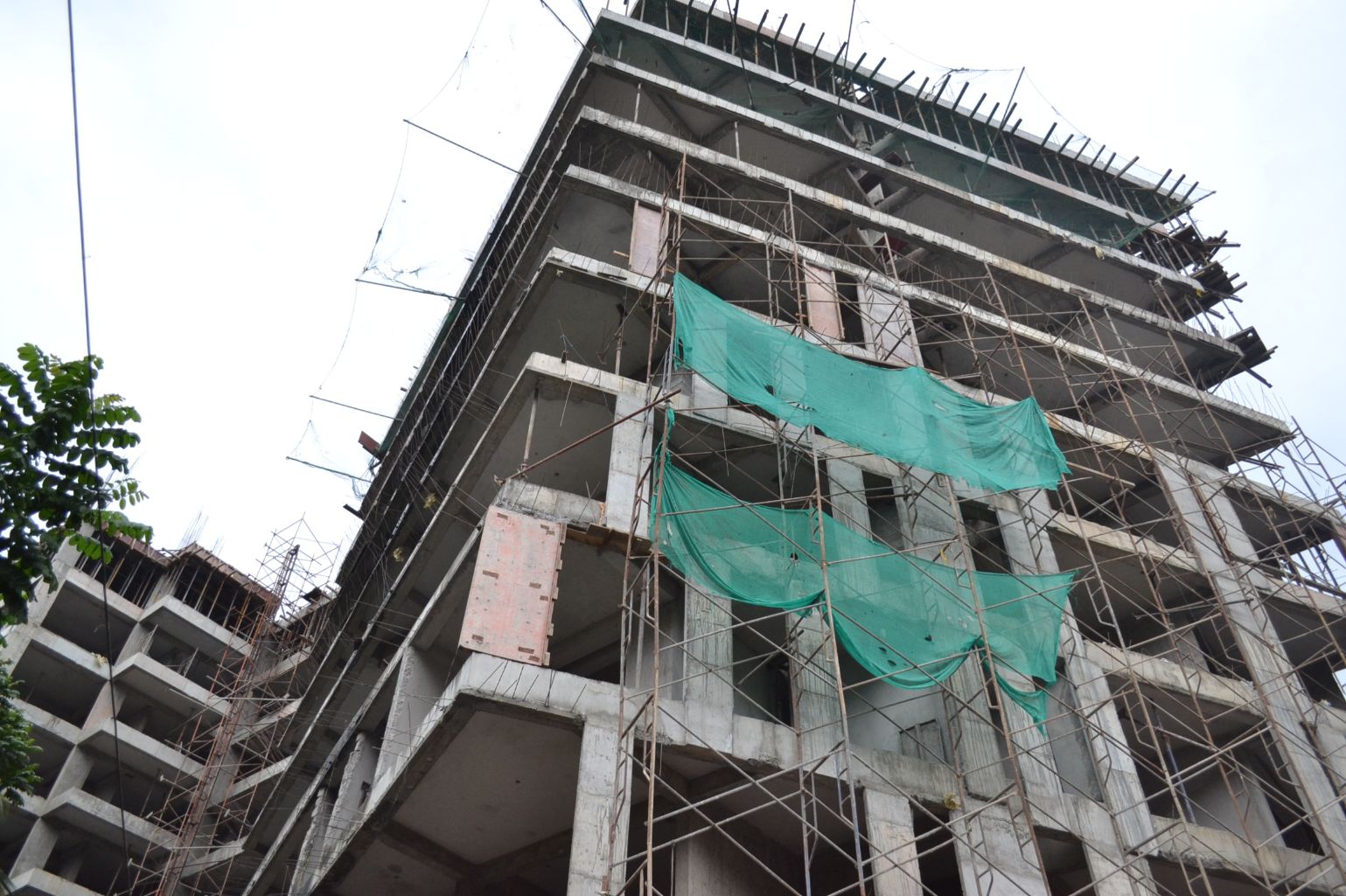

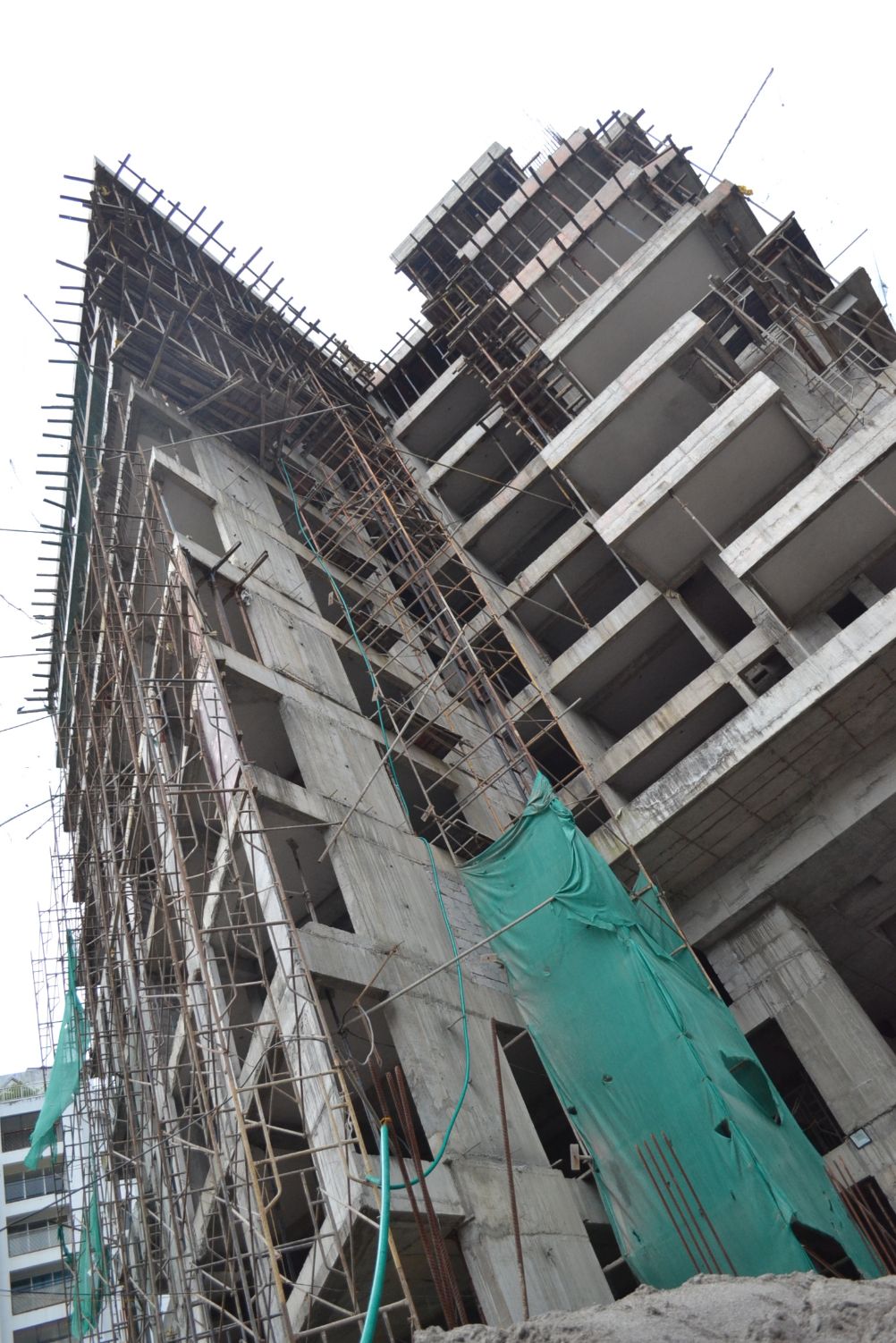

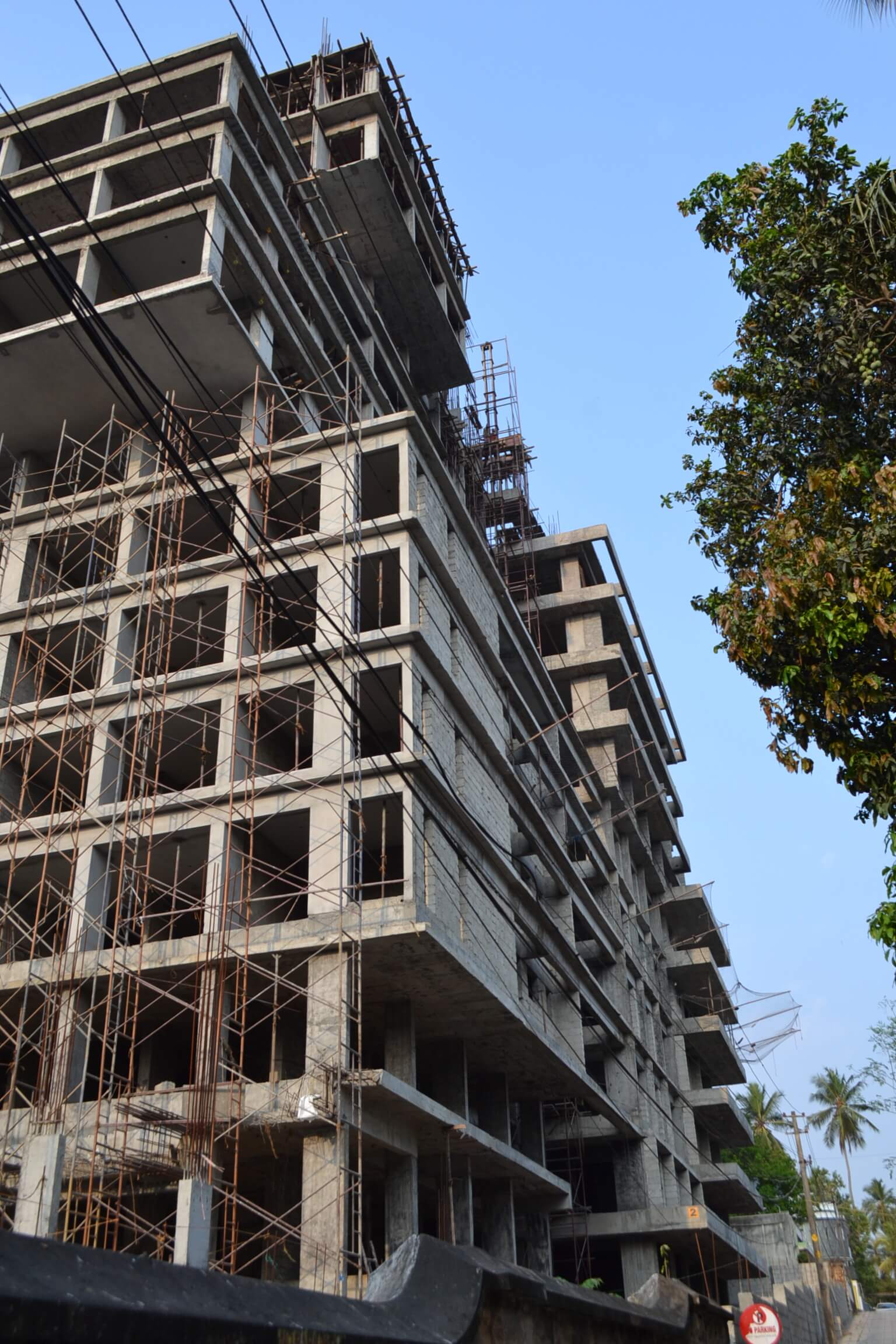

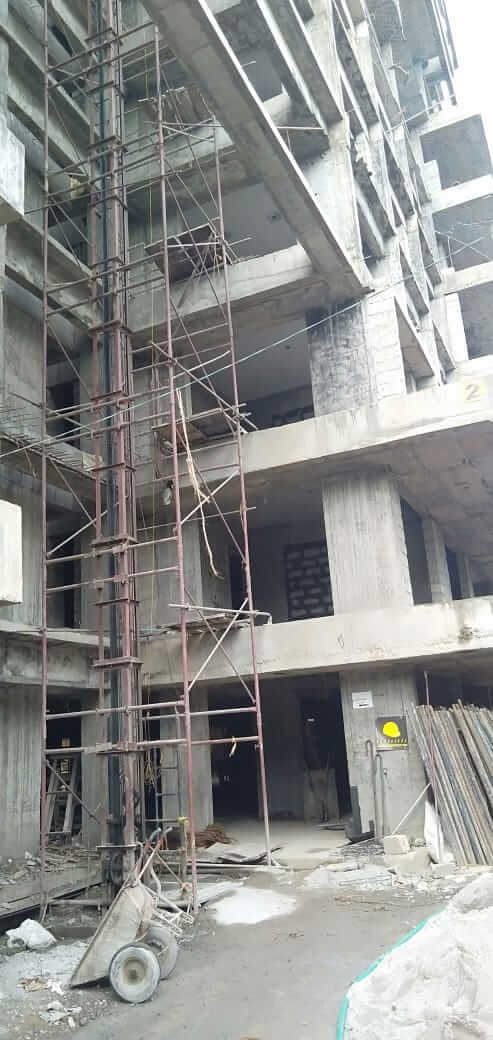

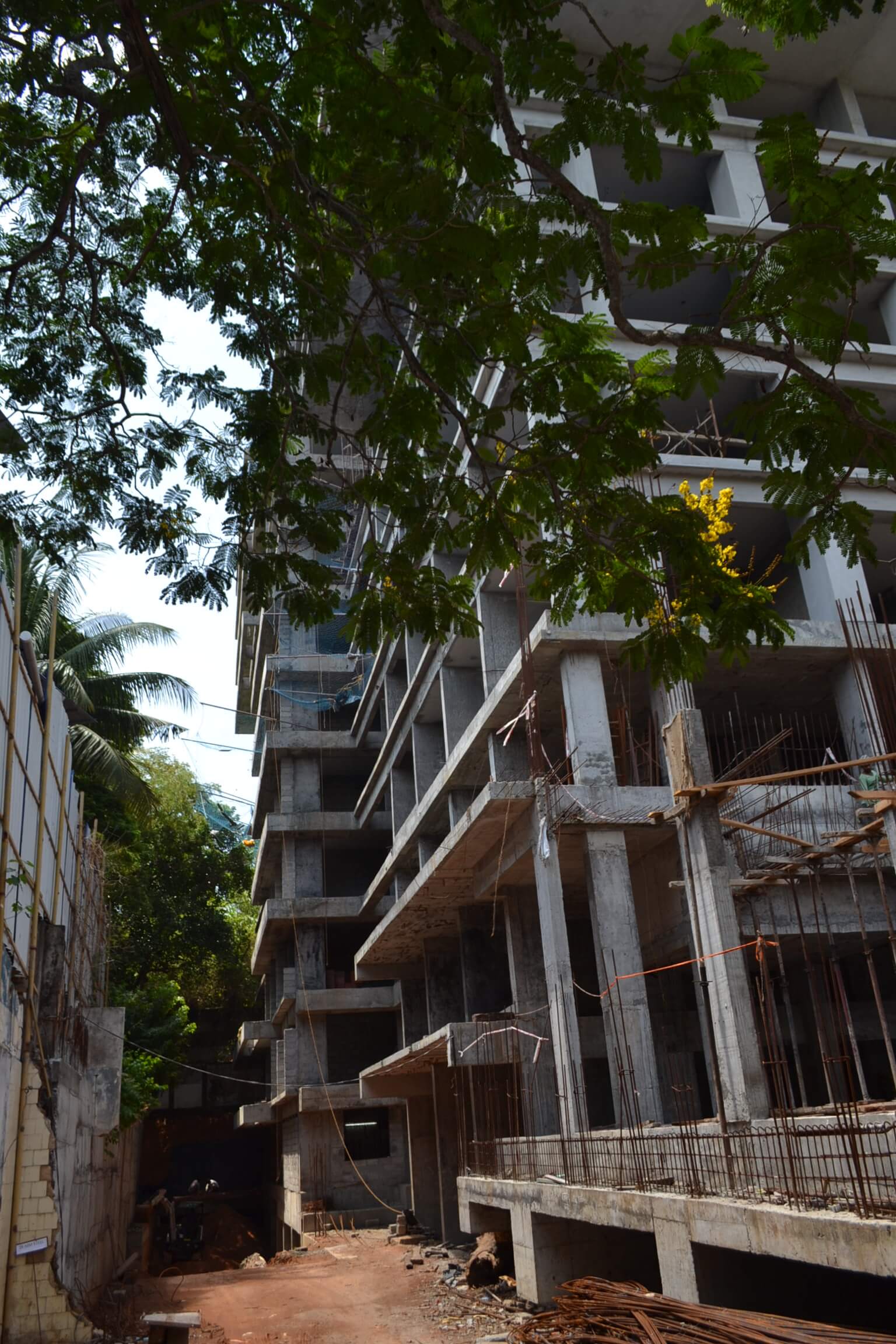

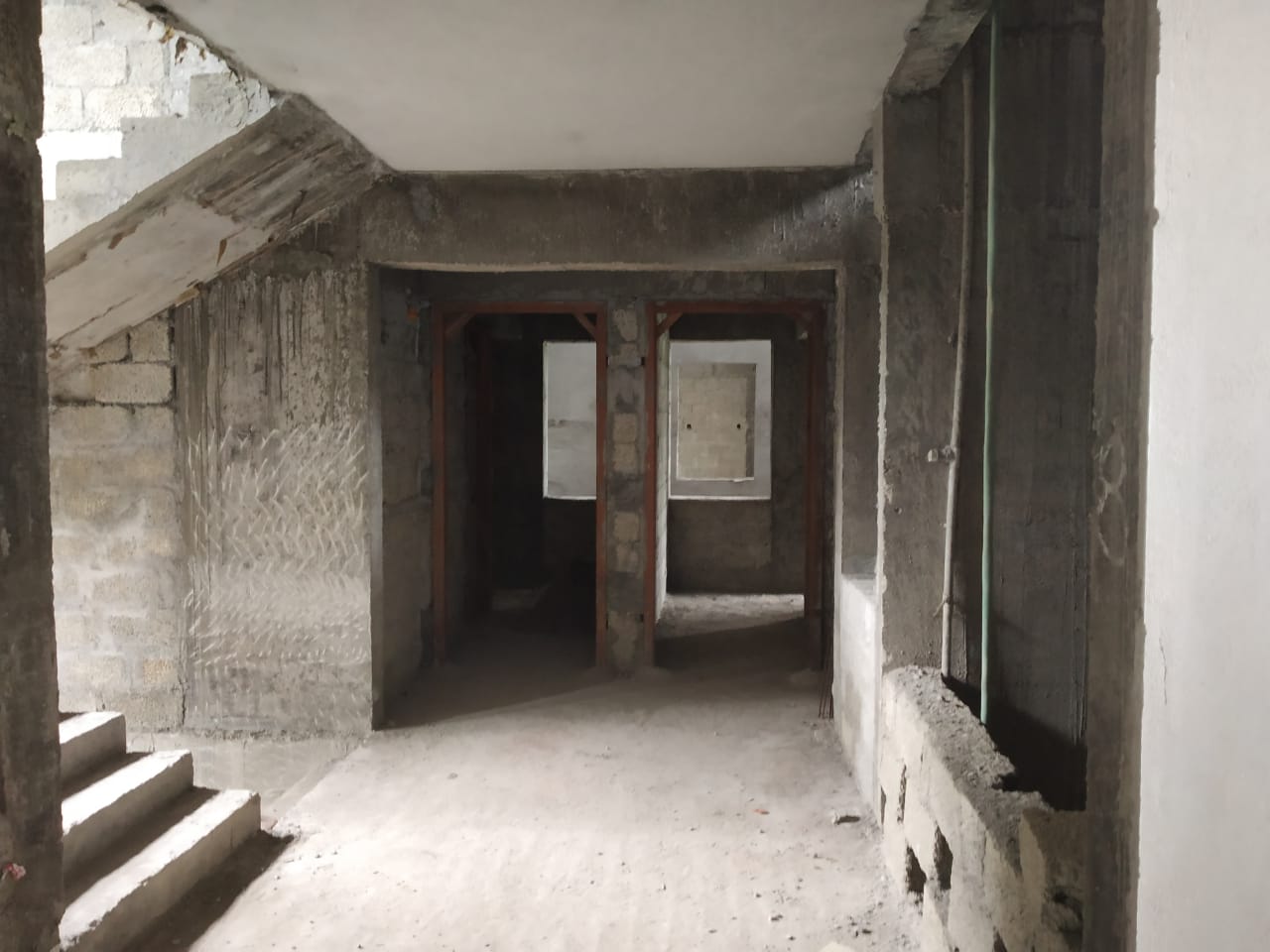

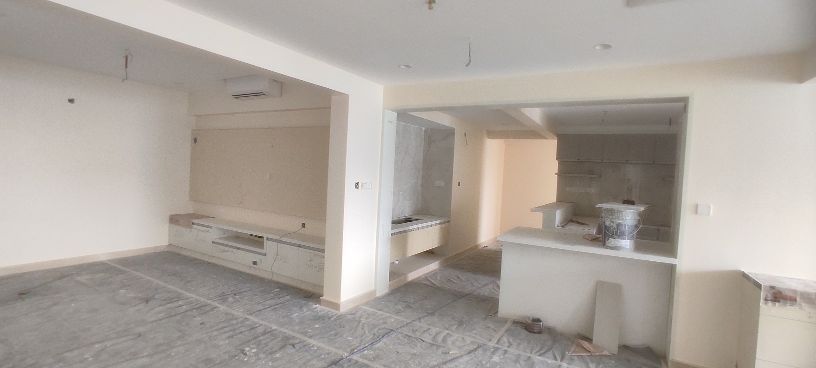

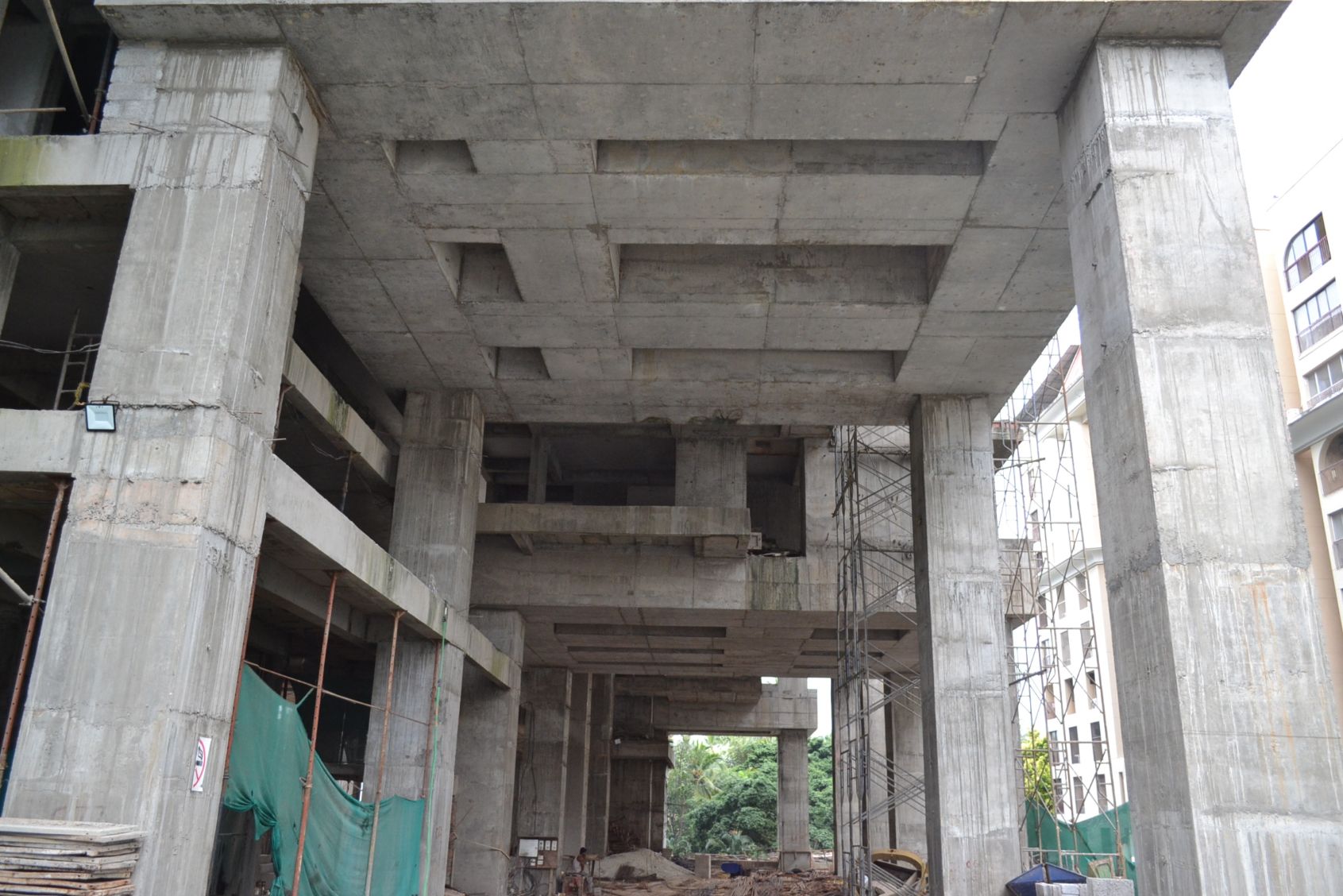

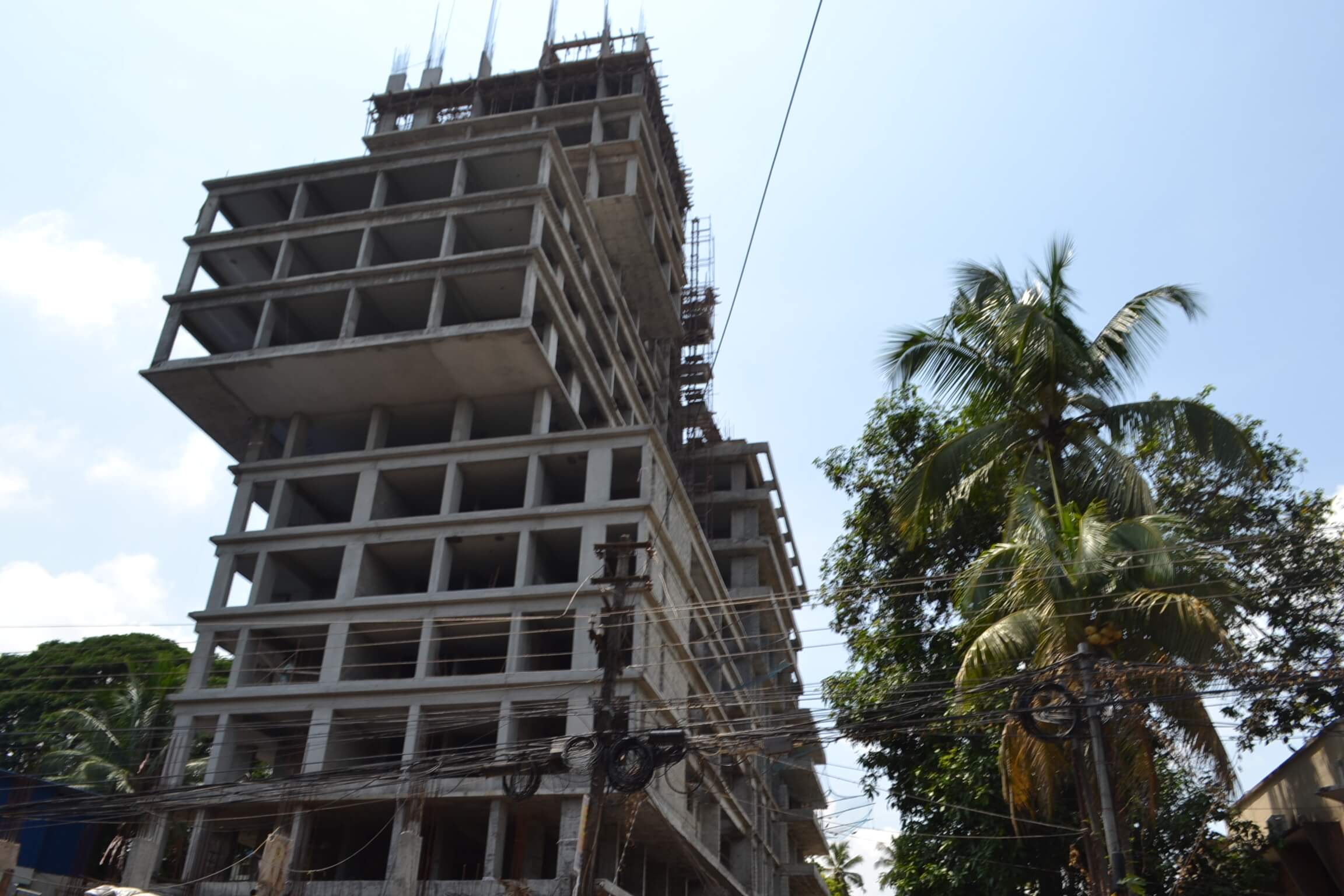

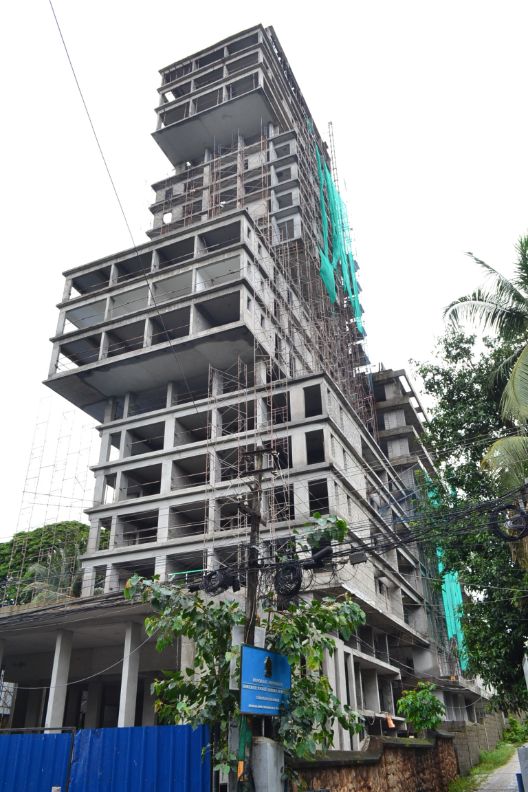

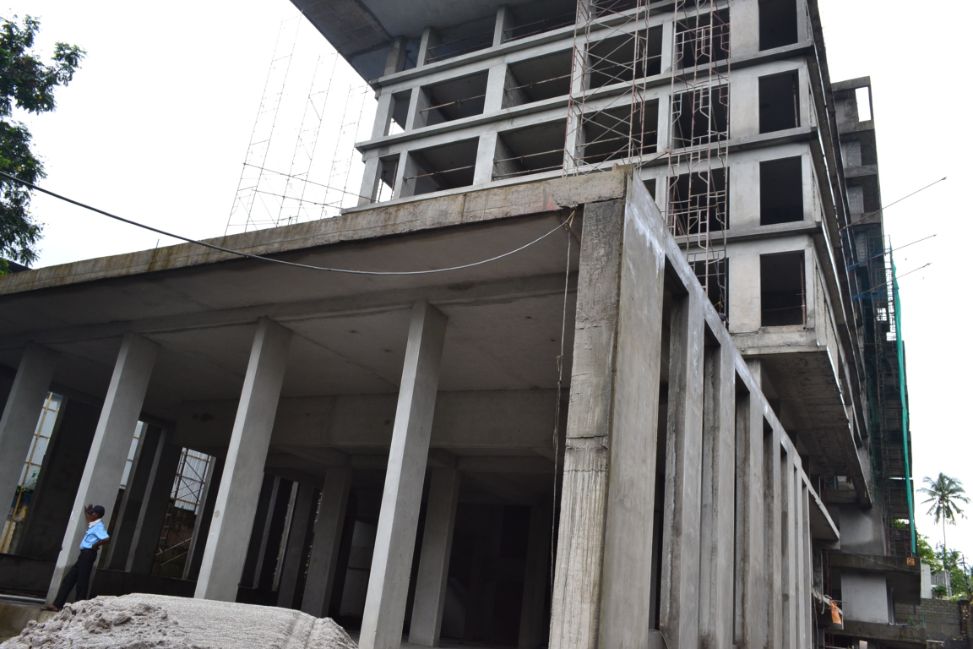

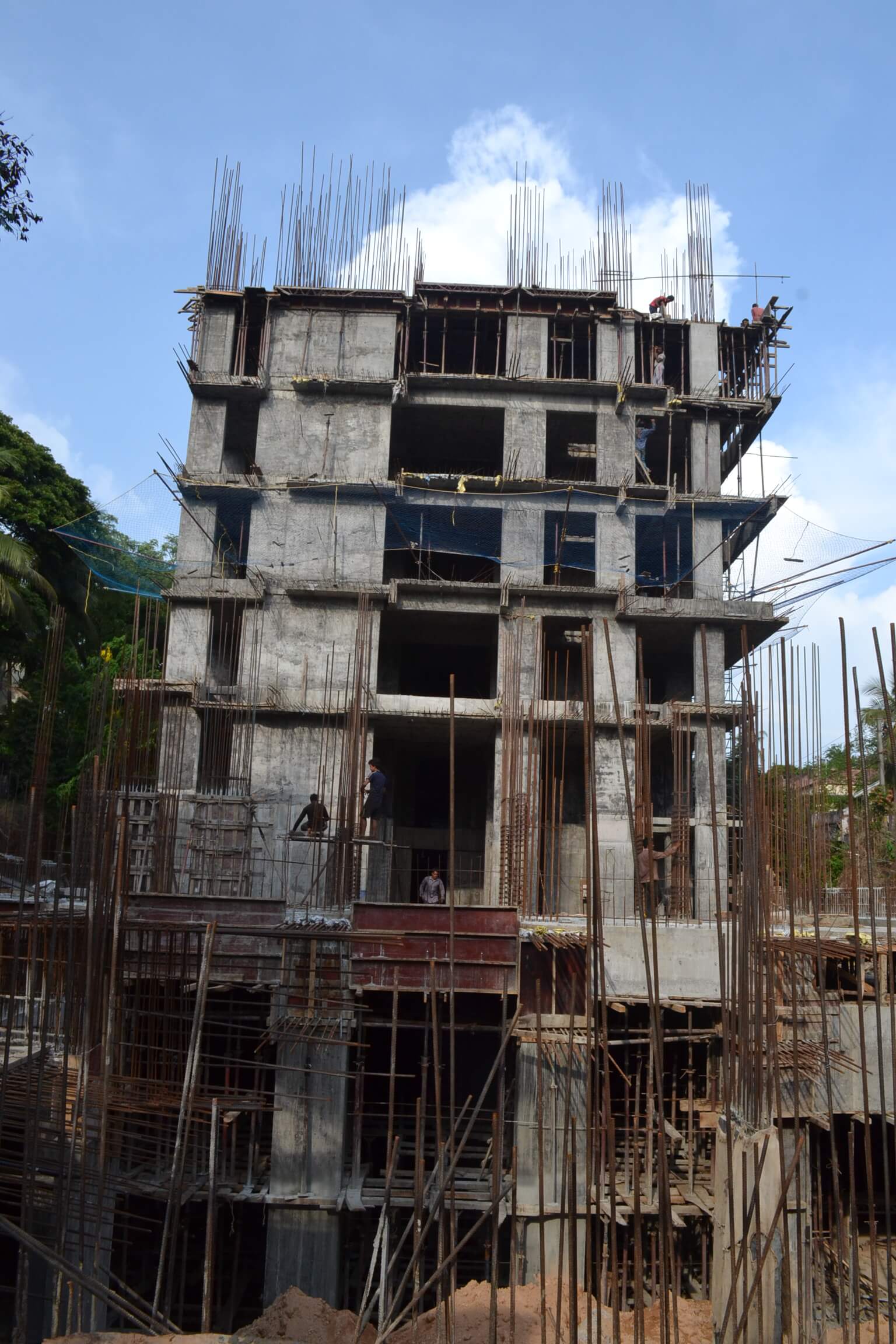

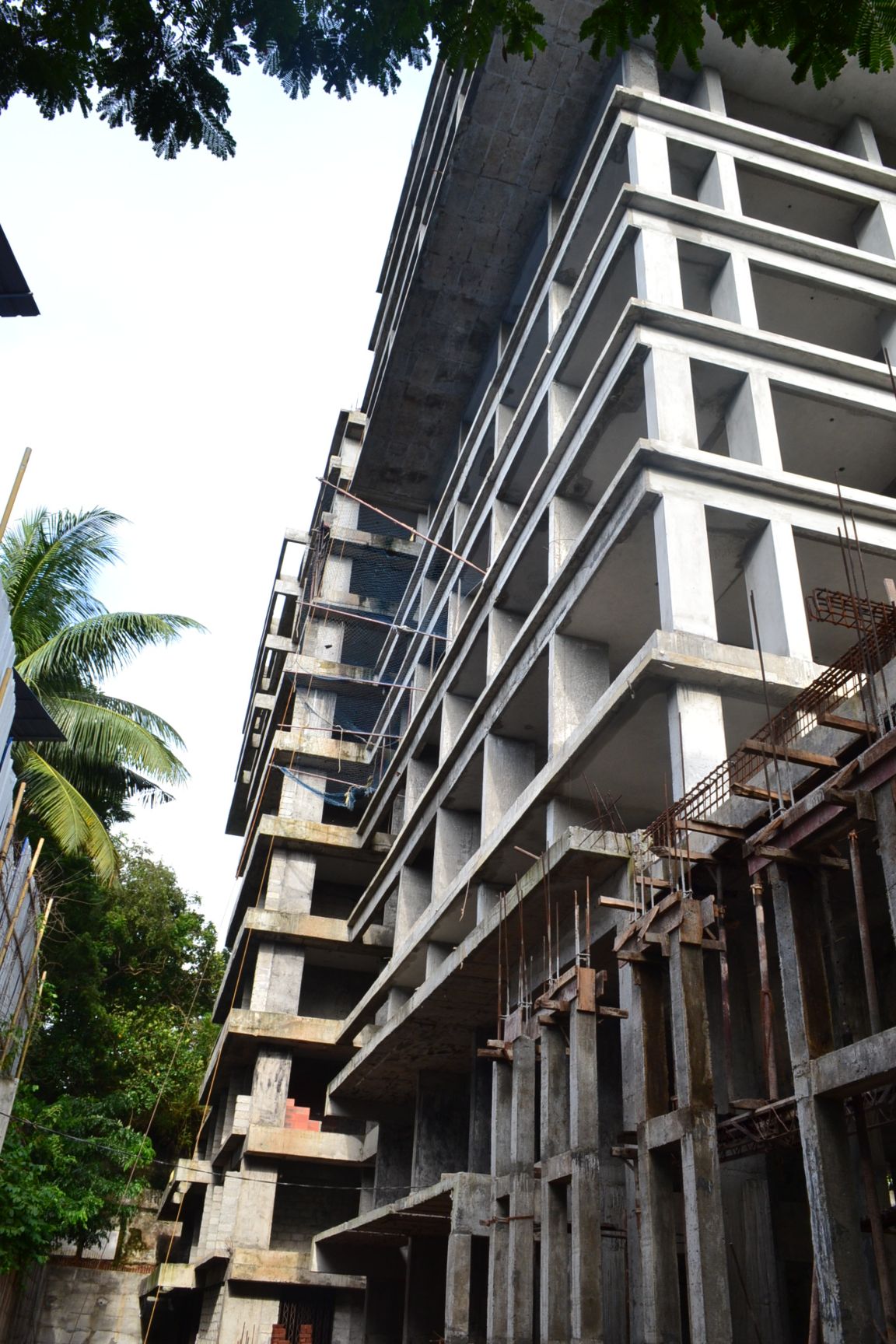

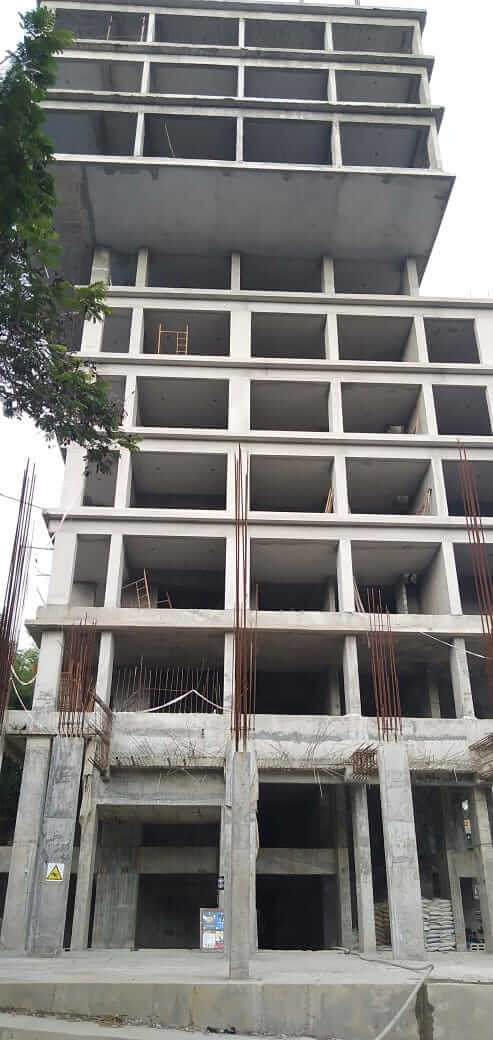

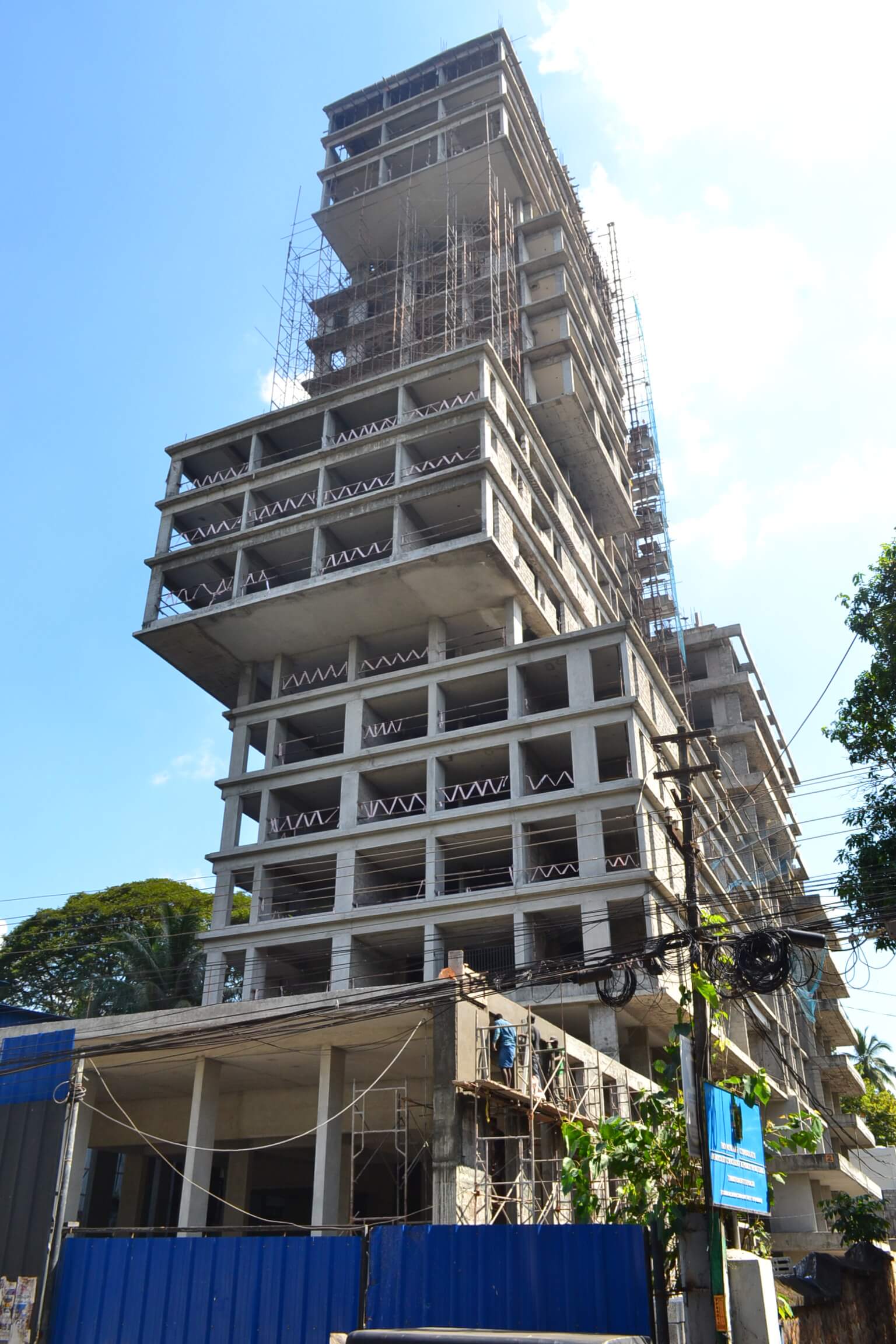

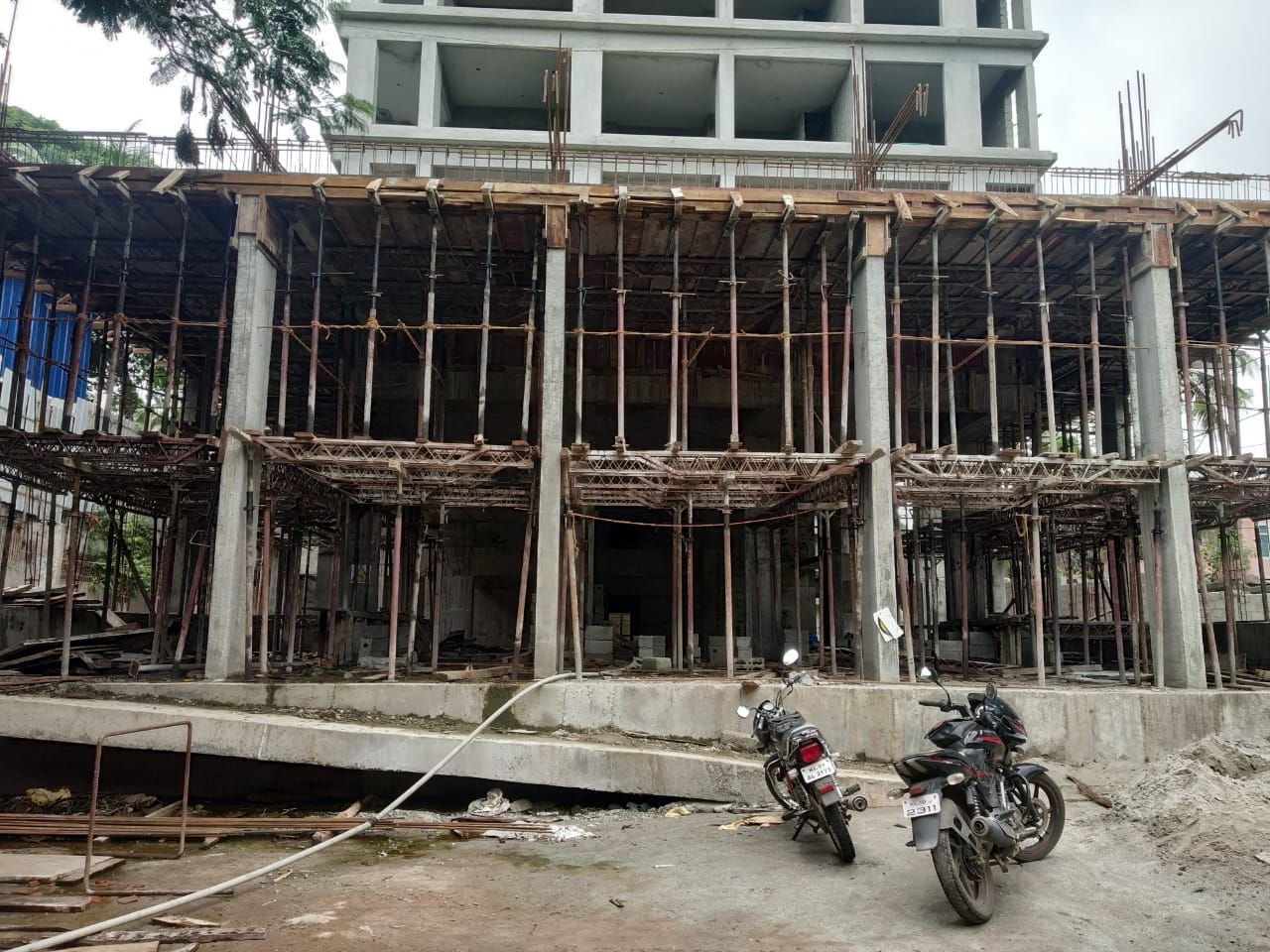

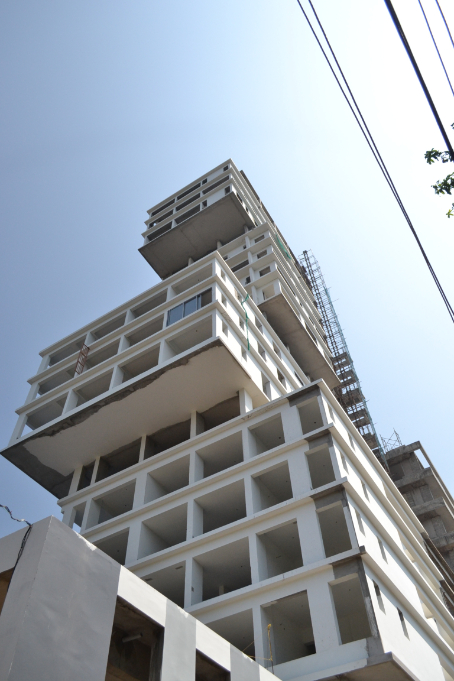

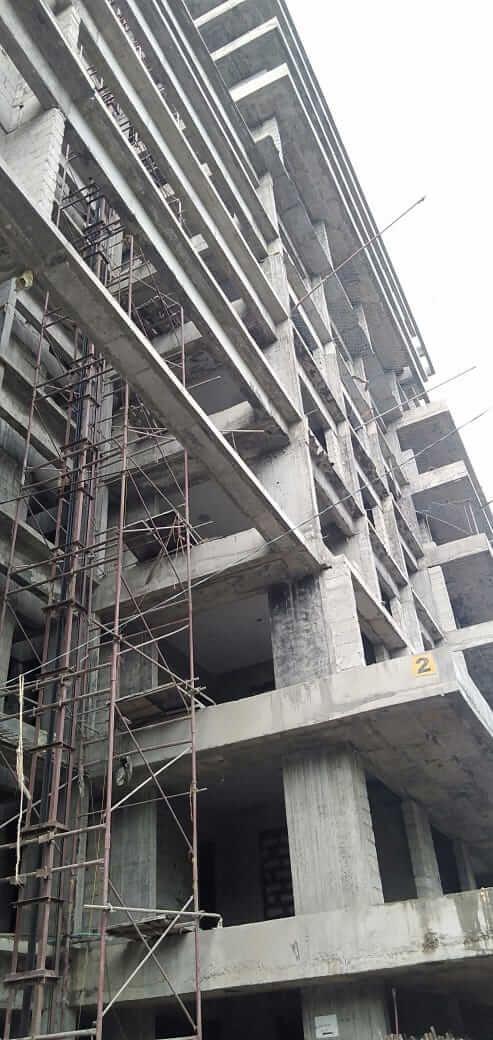

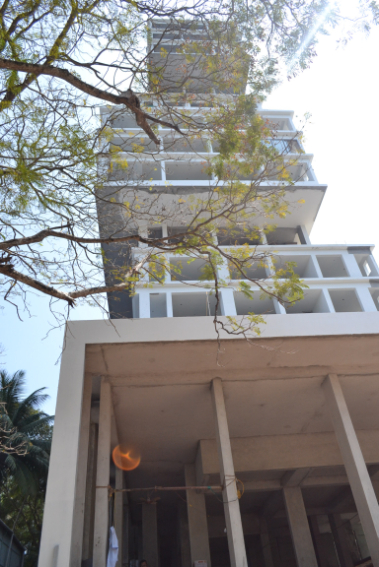

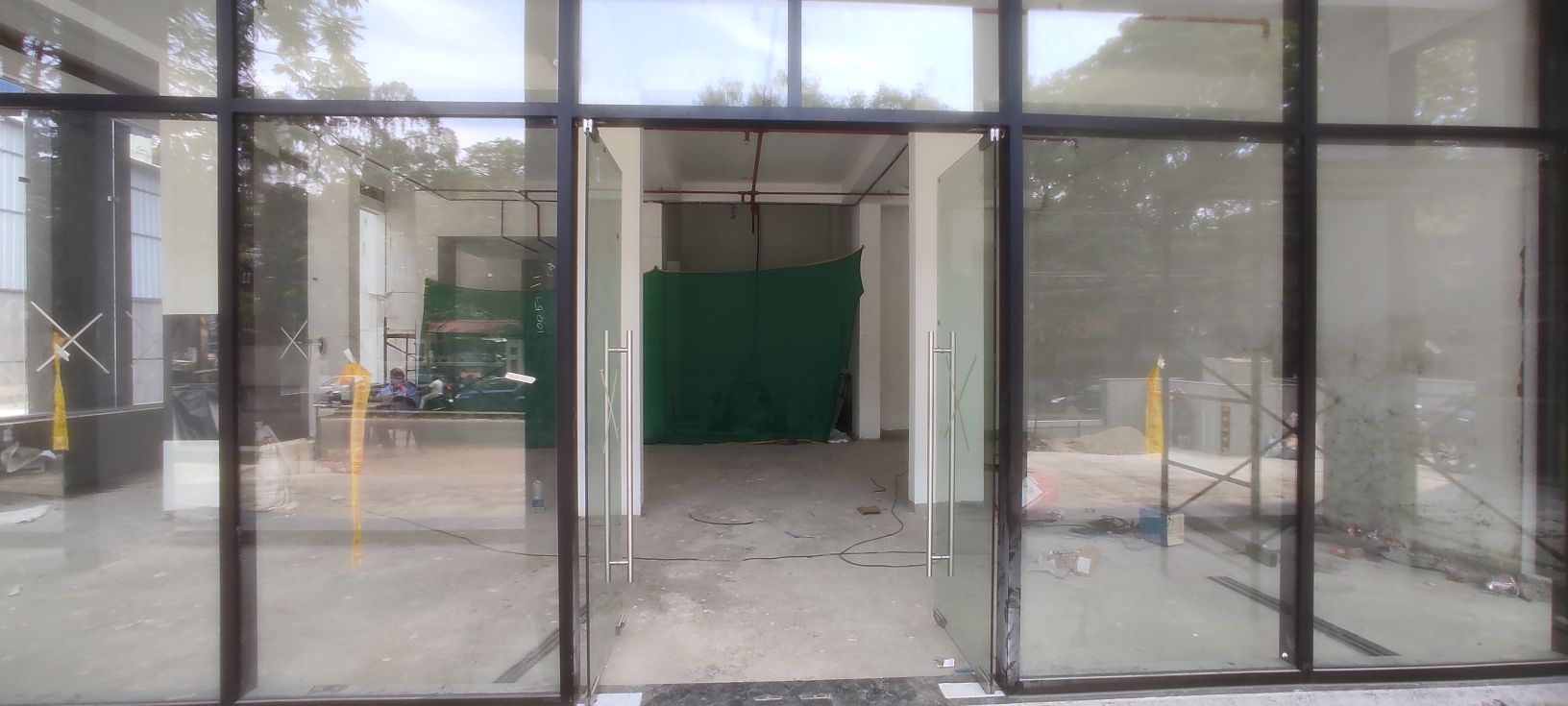

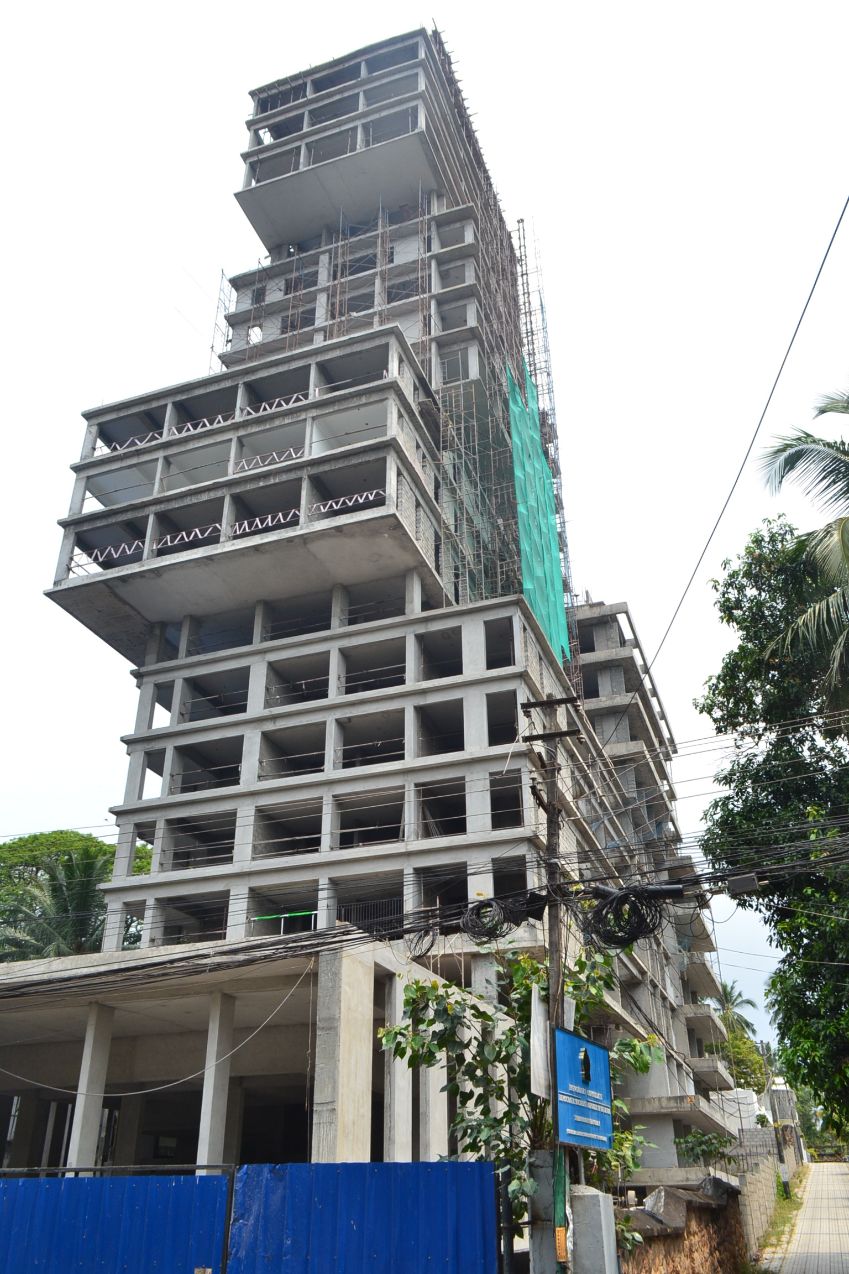

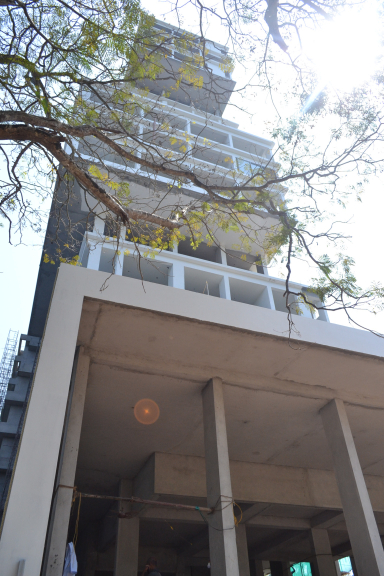

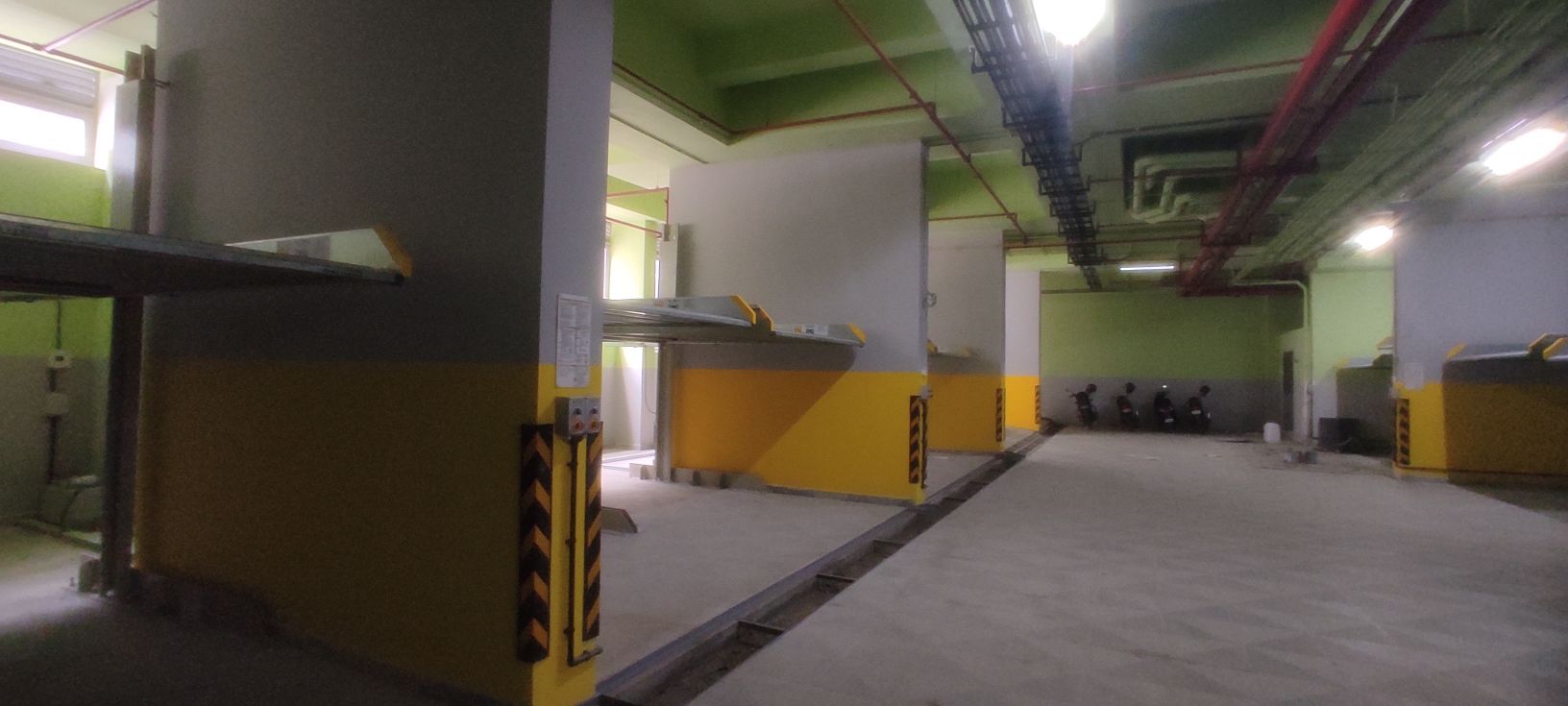

As per the current work status from our site, we are targeted to complete the following works by the end of APRIL 2021.

  • LT Electrical work -11th floor- 100% to be completed
  • Water Proofing balcony Work:19th floor terrace-100% to be completed.
  • External Plastering-(Right side)- 100% to be completed
  • Plumbing Work: Duct line work:-50% to be completed.
  • Tiling Work: -Mockup flat-100% to be completed.

Work status as on 11-03-2021, we have completed the following.

  • RCC – Structure completed
  • Block work – completed
  • Ceiling Plastering work – completed
  • Retaining wall -100% completed
  • LT Electrical work – upto 10th floor (100% completed),-12th floor-19th floor-100% completed.
  • Water Proofing  toilet Work: up to 19th floor-100% completed
  • Water Proofing balcony Work: up to 20th floor-100% completed.
  • External Plastering- (Frond portion, Rear Portion, left)-100% completed,(Left side)-100% completed, (Right side) – 75% completed
  • Plumbing balcony Work:- up to 15th floor:-100%completed.

As per the current work status from our site, we are targeted to complete the following works by the end of MARCH 2021.

  • LT Electrical work -11th floor- 100% to be completed
  • Water Proofing balcony Work: 11th floor &19th floor terrace-100% to be completed.
  • External Plastering-(Right side)- 100% to be completed
  • Plumbing balcony Work:- 16th -19th floor:-100% to be completed.

As per the current work status from our site, we are targeted to complete the following works by the end of February 2021

  • LT Electrical work -11th floor- 100% to be completed
  • Water Proofing toilet Work:18th floor-19th floor -100% to be completed.
  • Water Proofing balcony Work: 16th floor-20th floor-100% to be completed.
  • External Plastering-(Left side)- 100% to be completed
  • Plumbing balcony Work:- 11th -15thfloor:-100% to be completed.

Work status as on 09-02-2021, we have completed the following.

  • LT Electrical work – upto 10 th floor (100% completed),-12th floor-19th floor-100% completed.
  • WaterProofing toilet Work: up to 17th floor-100% completed
  • Water Proofing balcony Work: up to 15th floor-100% completed.
  • External Plastering- (Frond portion,Rear Portion,left)-100% completed,(Left side)-80% completed, (Right side) – 75% completed
  • Plumbing balcony Work:- up to 10th floor:-100%completed.

As per the current work status from our site, we are targeted to complete the following works by the end of JANUARY 2021

  • LT Electrical work – 16th floor-19th floor- (100% )to be completed.
  • Water Proofing toilet Work: 16th floor-19th floor -100% to be completed.
  • Water Proofing balcony Work: 11th floor-15th floor-100% to be completed.
  • External Plastering-(Left side)- 100% to be completed
  • Plumbing balcony Work:- 11th -15thfloor:-100% to be completed.

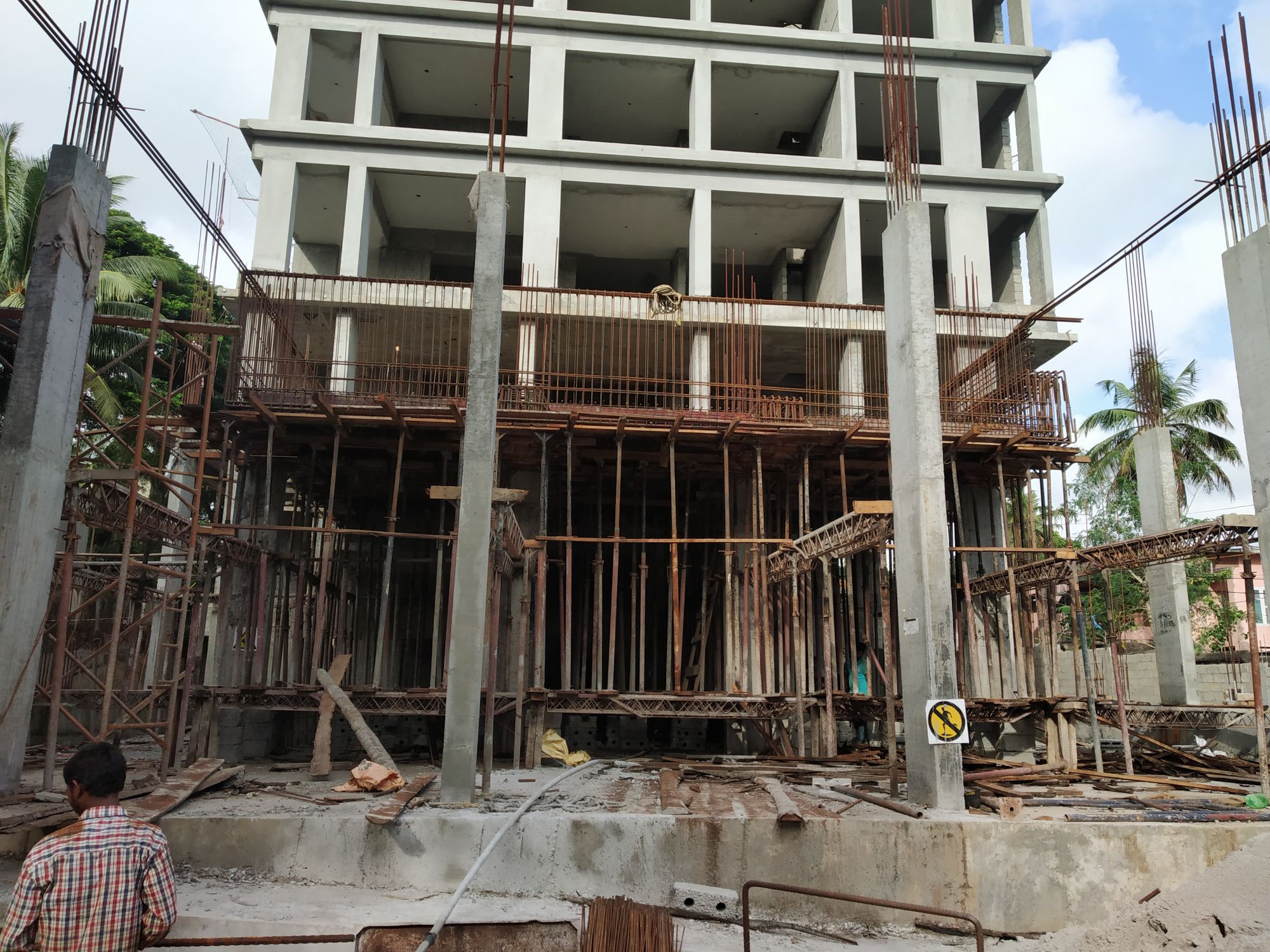

Work status as on 07-01-2021, we have completed the following.

  • Block work – completed
  • Ceiling Plastering work – completed
  • Retaining wall -100% completed
  • LT Electrical work – upto 10 th floor (100% completed),-12th floor-19th floor-100% completed.
  • Water Proofing toilet Work: 3rd -10th floor-100% completed,11th-15th-100% completed
  • Water Proofing balcony Work: up to 10th floor-100% completed.
  • External Plastering- (Frond portion,Rear Portion,left)-100% completed,(Left side)-50% completed, (Right side) – 75% completed
  • Plumbing Work : up to 10th floor:-100%completed.

As per the current work status from our site, we are targeted to complete the following works by the end of July 2020

  • Block work -16th-17th floor:- (100 % to be completed)
  • Ceiling Plastering work :-18th floor :- 100% to be completed
  • LT Electrical work – upto7 th floor (100% )to be completed, 8th(B,C):-70% to be completed.
  • Water Proofing Work : 8th-9th floor -100% to be completed.
  • Plumbing Work: 1st -5th floor:-70% to be completed.

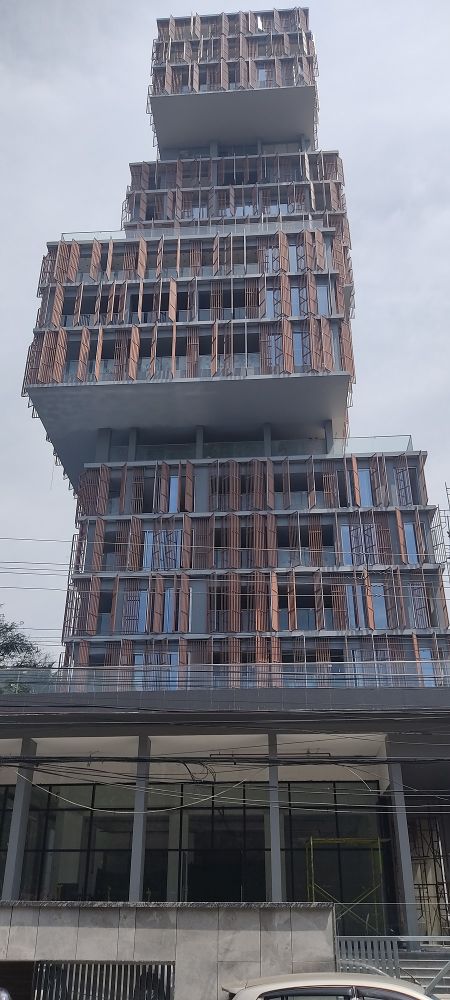

Work status as on 11-06-2020, we have completed the following.

  • Block work – 1st floor,3rd -14 th floor (100%completed); 2nd floor( 70% completed), 15th floor :-100% completed, 16th floor-90% completed.
  • Ceiling Plastering work -Gf -70%,1 st floor -70%, 2nd floor (100% completed); 3rd floor-17 th floor -100% completed,18th floor :- 20% completed.
  • Slab work – BF to 22nd (machine room ) (100% completed)

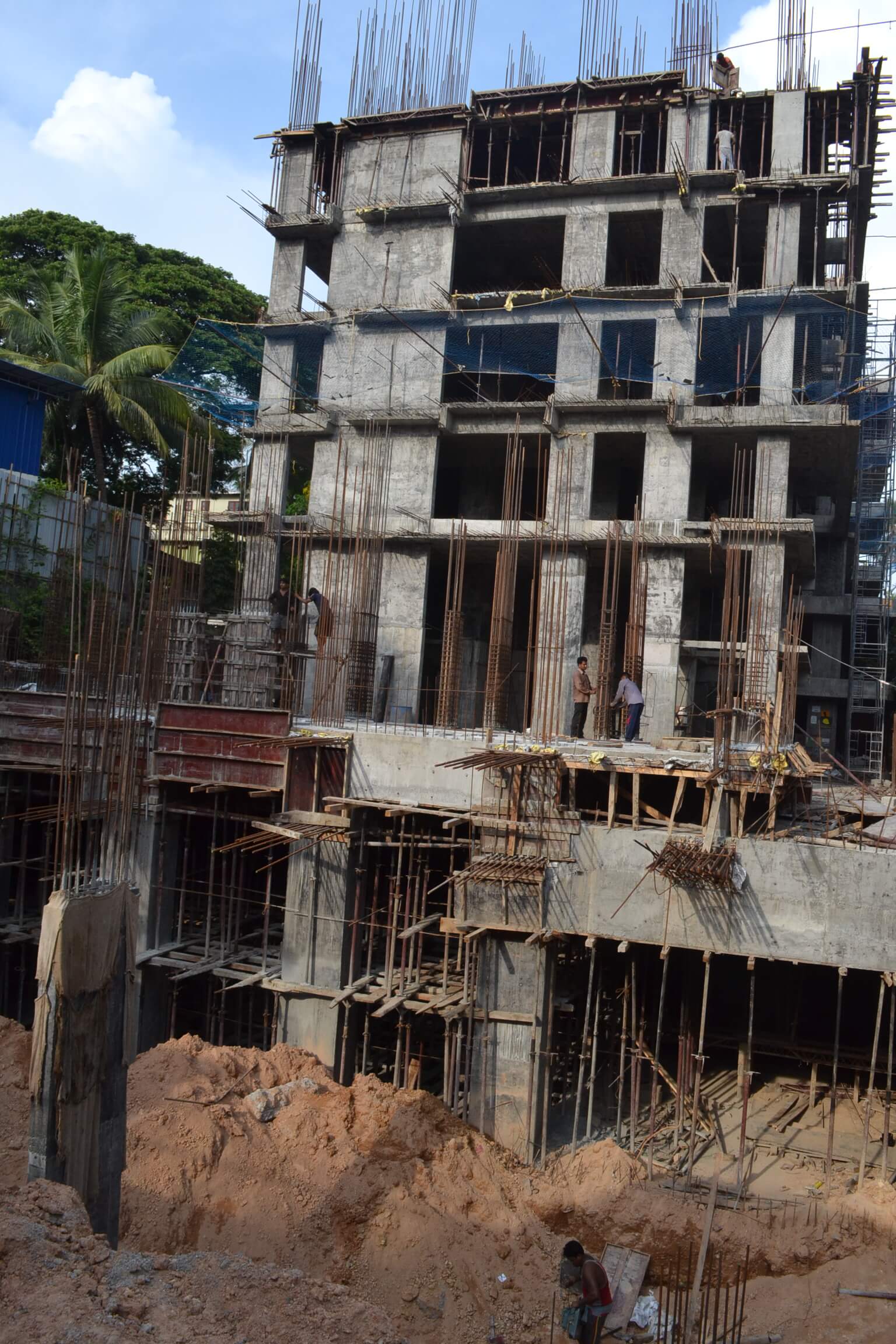

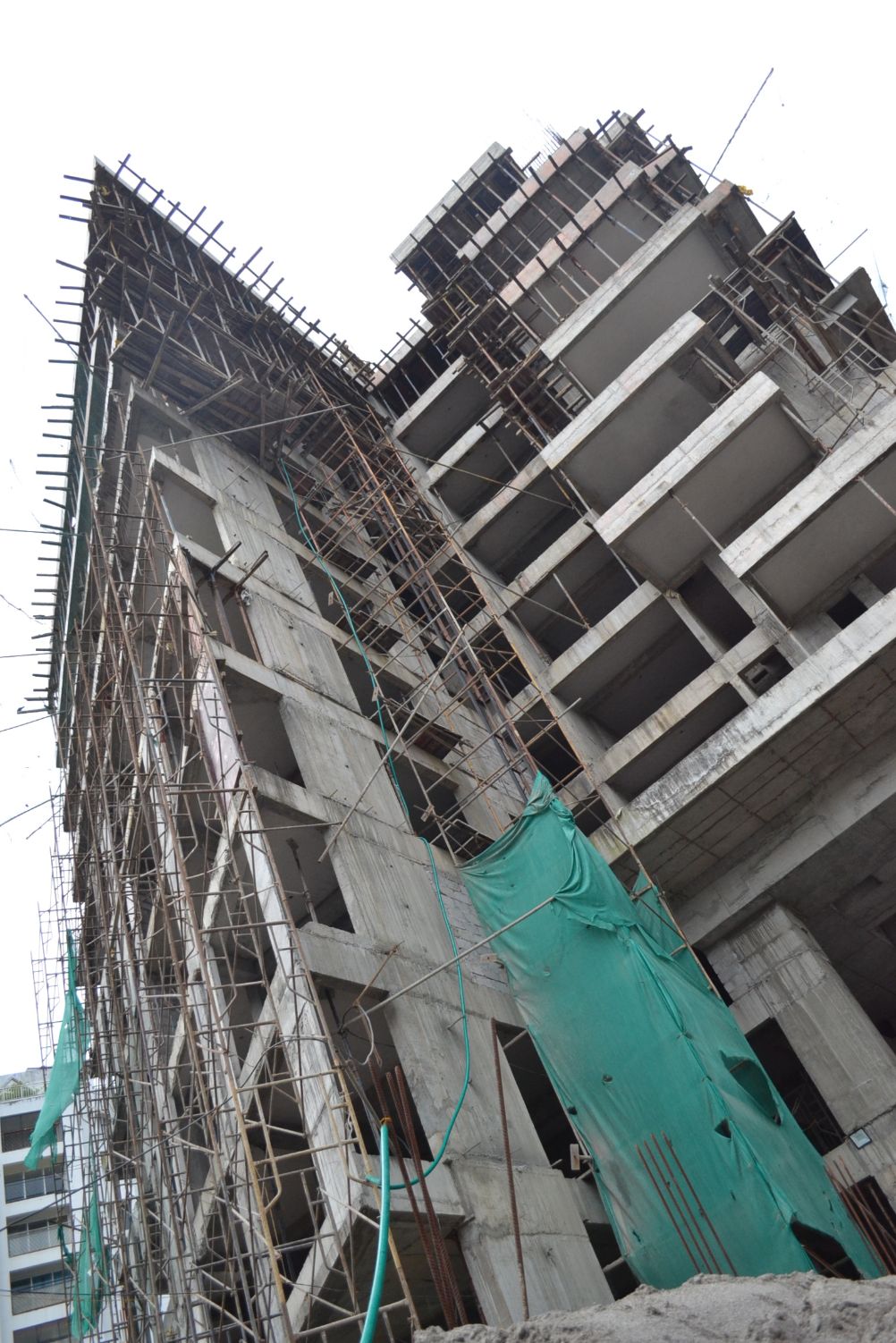

  • Retaining wall -100% completed
  • LT Electrical work – upto 5 th floor (70% completed), 6th-7th floor: (B,C)-70% completed, 8th floor:-20% completed.
  • Water Proofing Work :upto 7th floor -70% completed,8th floor :-20% completed.
  • Plumbing Work : 1st -5th floor :-20% completed.

As per the current work status from our site, we are targeted to complete the following works by the end of March 2020

  • Block work -17th floor (100 % to be completed)
  • Ceiling Plastering work :-17th floor – 100% to be completed
  • Roof slab work – (machine room ) roof slab (100% to be completed),22nd :-100% to be completed.
  • LT Electrical work – upto8 th floor (70% )to be completed
  • Water Proofing Work : 1st -3rd floor -100% to be completed.

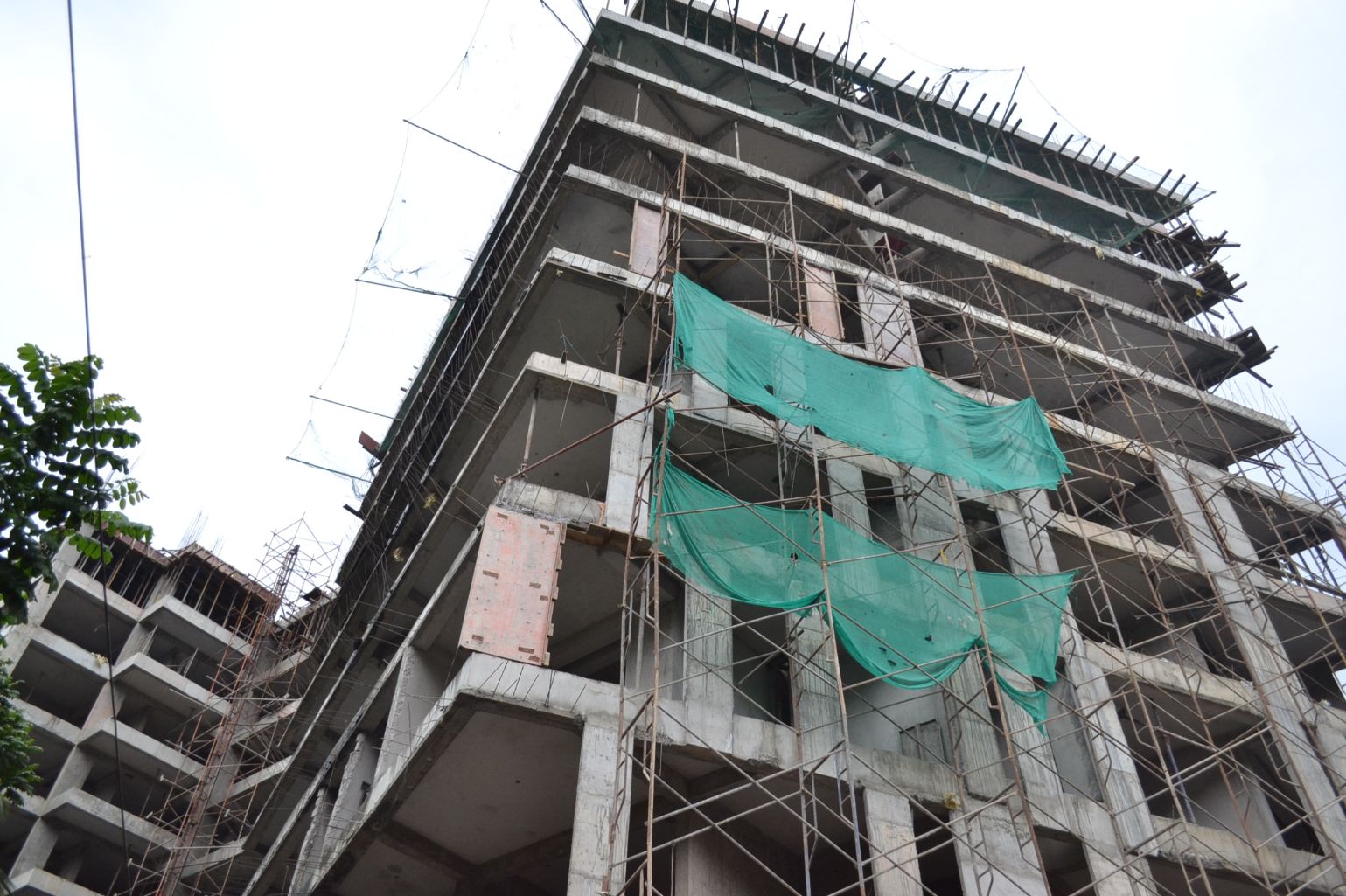

Work status as on 11-03-2020, we have completed the following.

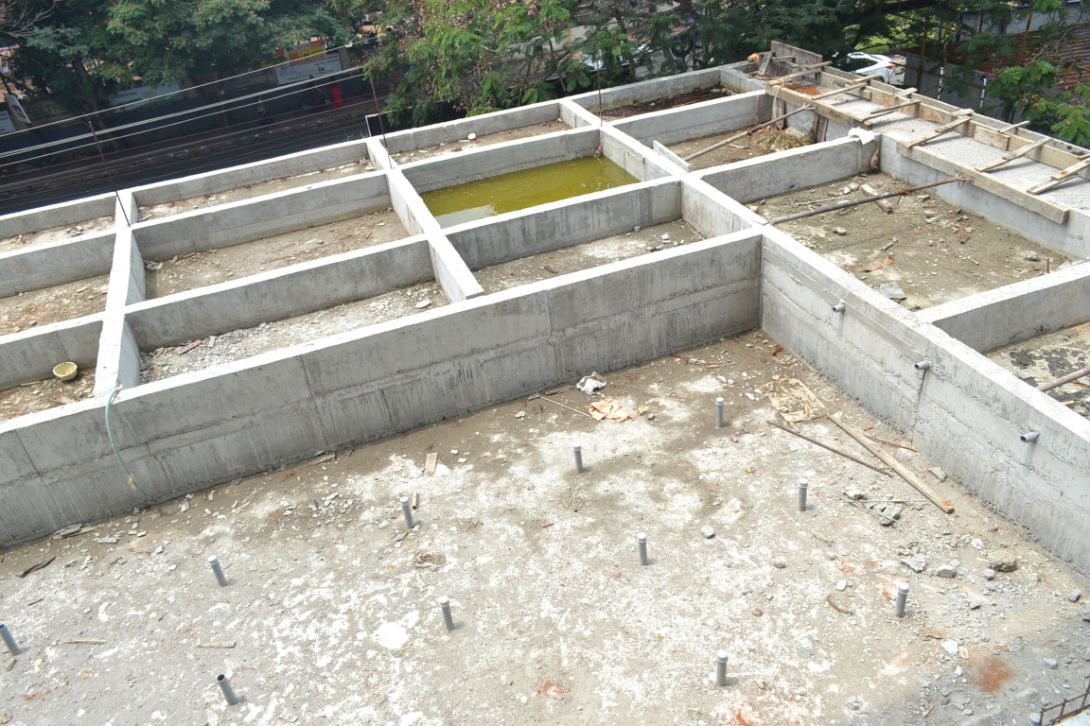

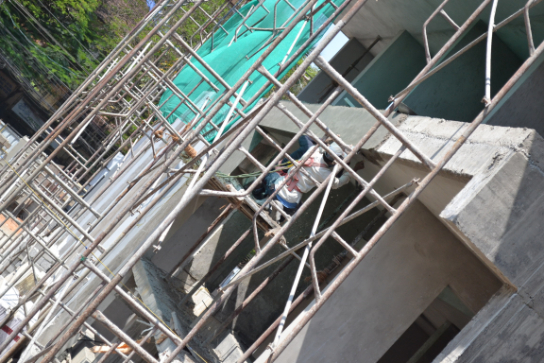

  • Piling work – 100% completed

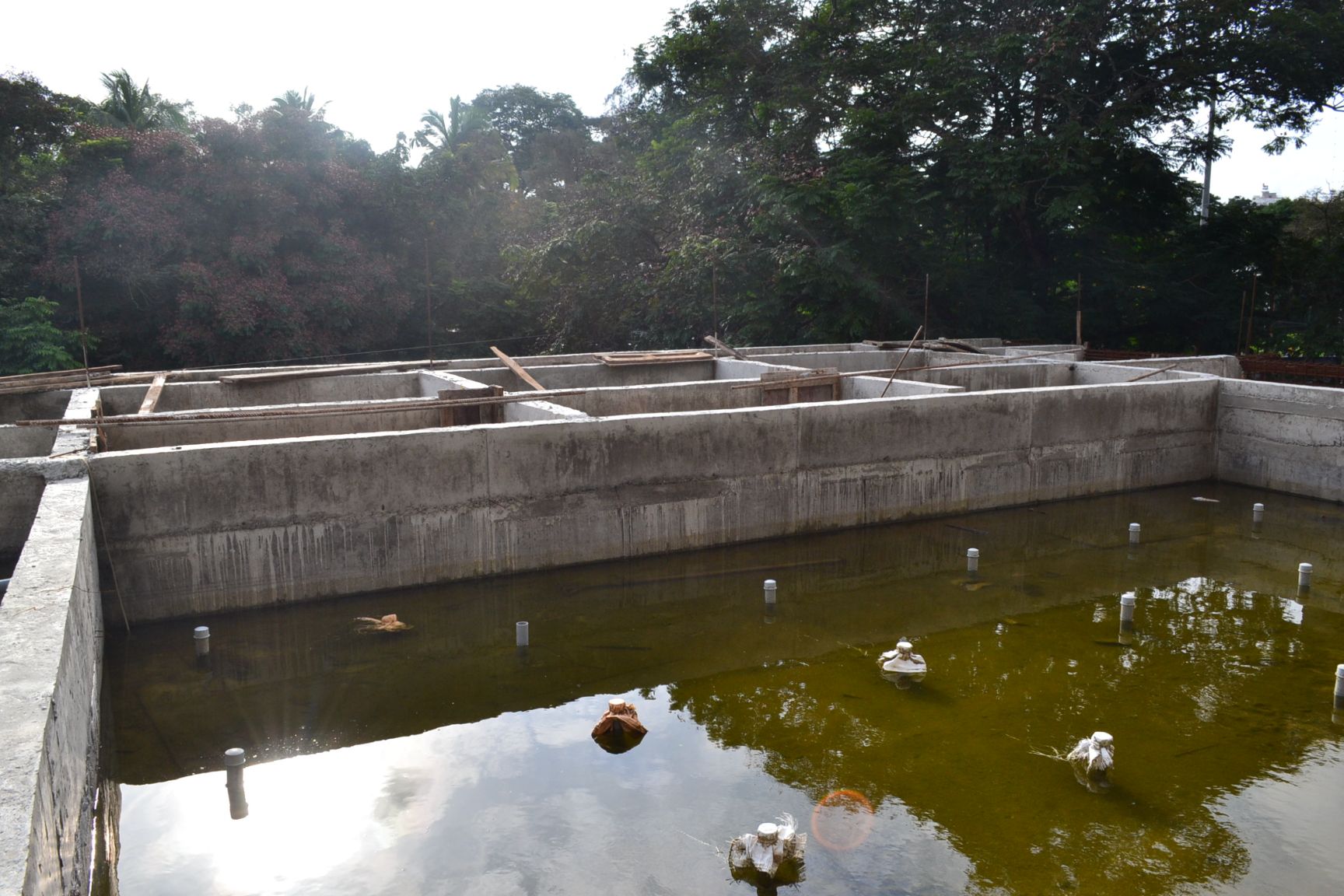

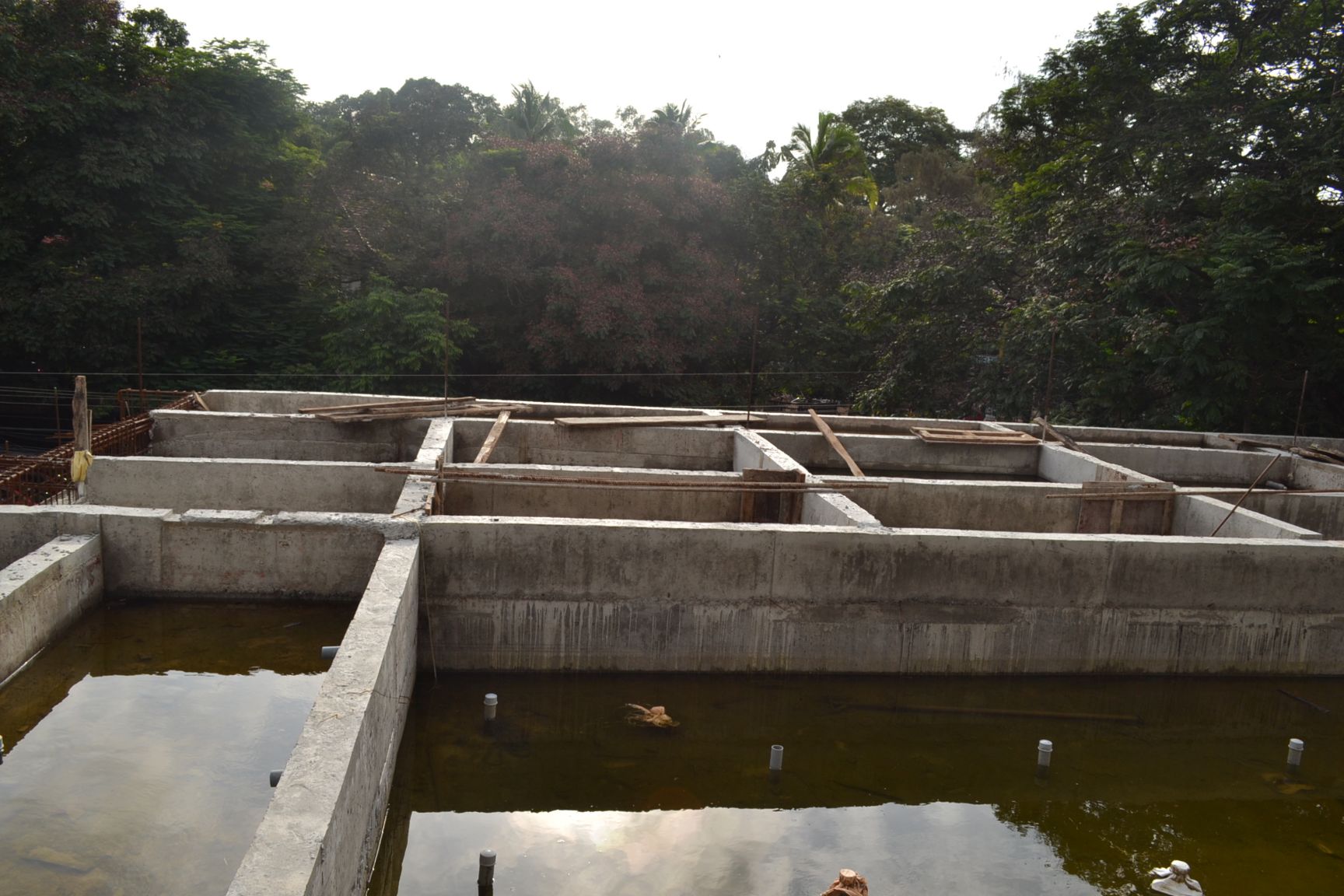

  • Pile chipping work – 100% completed
  • Pile cap work – 100% completed
  • BF column work – 100% completed
  • Block work – 1st floor,3rd -14 th floor (100%completed); 2nd floor( 70% completed), 15th floor :-100% completed, 16th floor-70% completed.
  • Ceiling Plastering work -Gf -70%,1 st floor -70%, 2nd floor (100% completed); 3rd floor-14 th floor (100% completed),15th floor :-100% completed. 16th floor-100% completed.
  • slab work – BF to 21st(machine room) (100% completed)
  • Retaining wall -100% completed
  • LT Electrical work – upto 5 th floor (70% completed )
  • Water Proofing Work : 1,2,3 ,4 th ,5th,6th,7th floor -70% completed.

As per the current work status from our site, we are targeted to complete the following works by the end of February 2020

  • Block work -16th floor (100 % to be completed)
  • Ceiling Plastering work: 16th floor – 100% to be completed
  • Roof slab work – (machine room) roof slab (100% to be completed), 22nd: 100% to be completed.

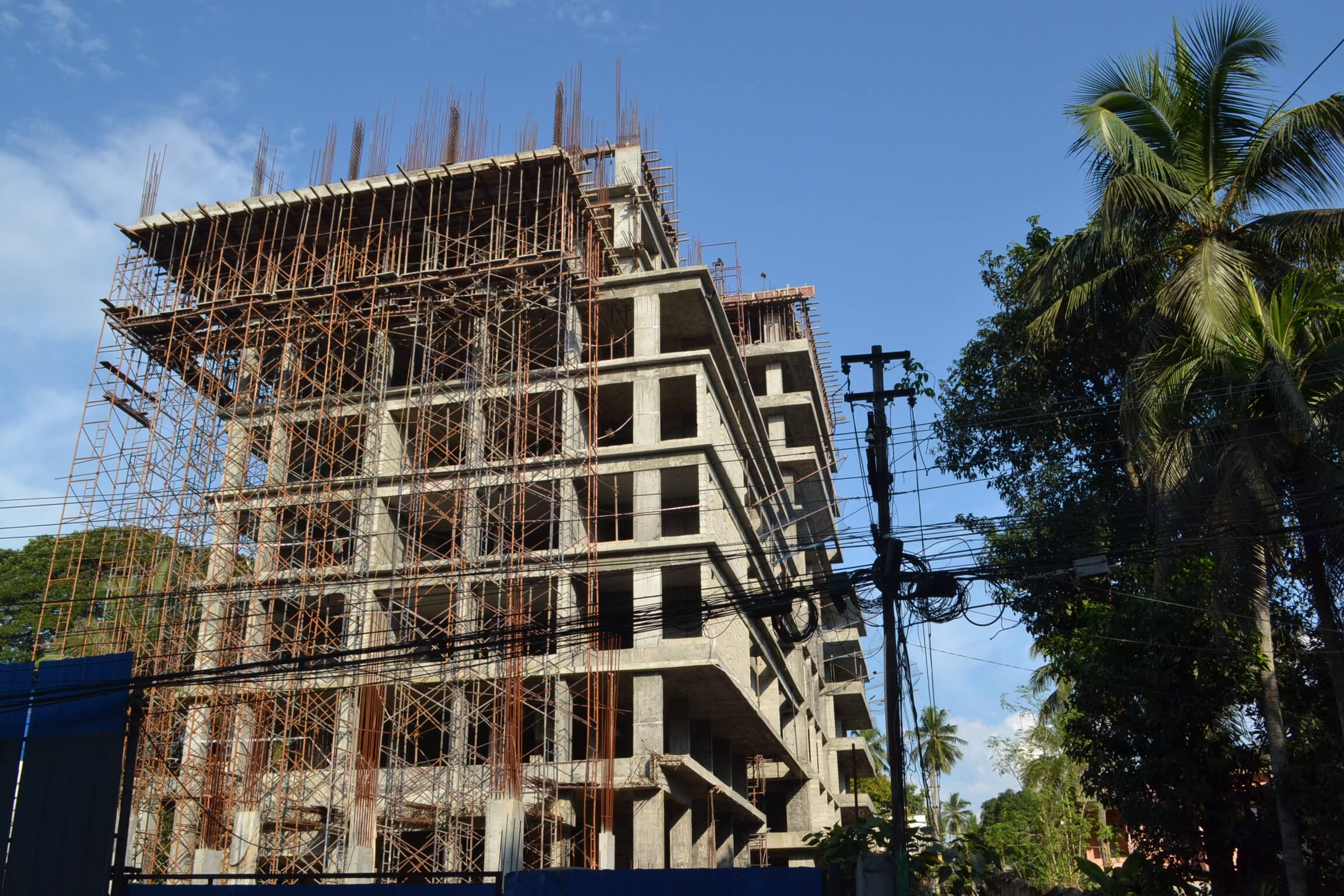

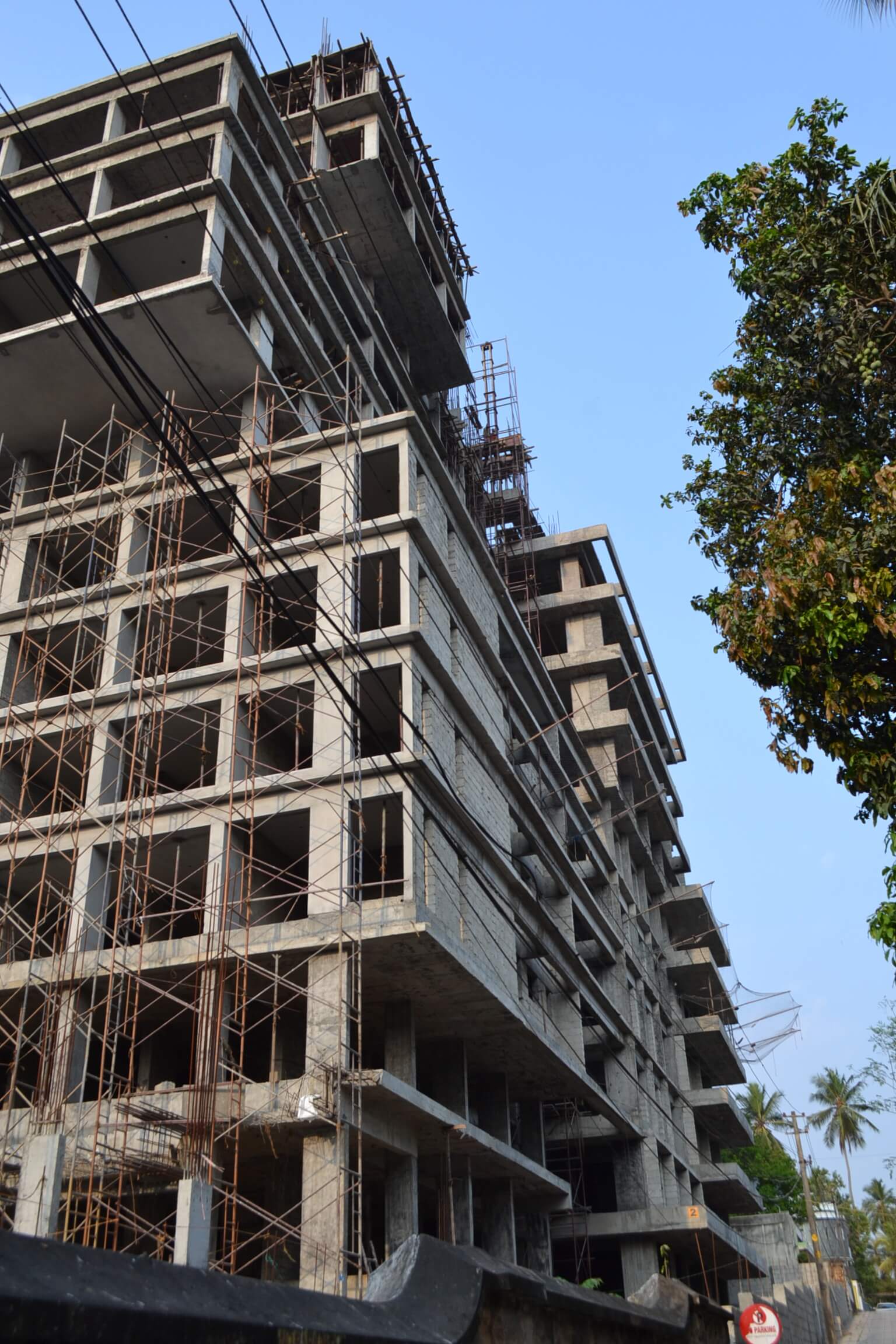

  • LT Electrical work – upto 7th floor (70% )to be completed
  • Water Proofing Work : 7th floor -70% to be completed.

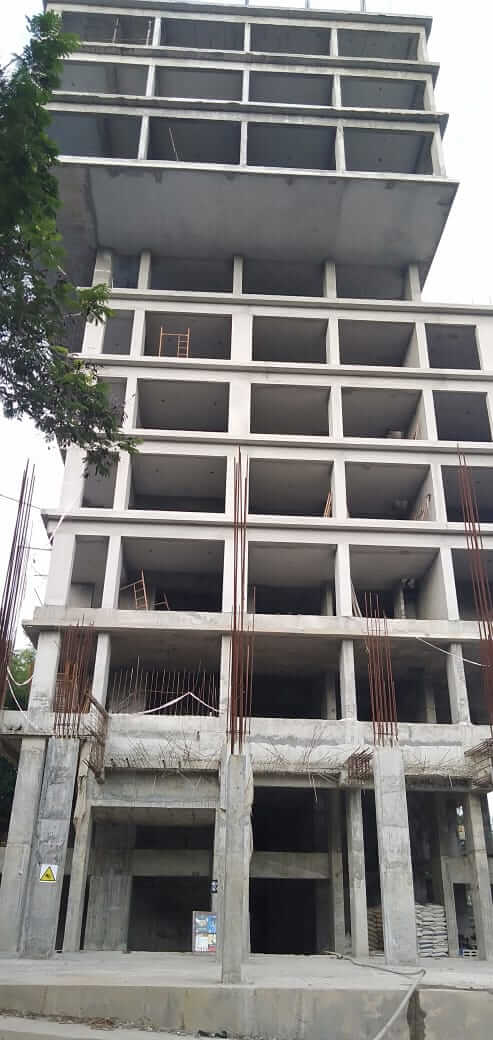

Work status as on 08-02-2020, we have completed the following.

  • Piling work – 100% completed
  • Pile chipping work – 100% completed
  • Pile cap work – 100% completed
  • BF column work – 100% completed
  • Block work – 1st floor,3rd -14 th floor (100%completed); 2nd floor( 70% completed), 15th floor :-100% completed.
  • Ceiling Plastering work -Gf -70%, 1st floor -70%, 2nd floor (100% completed); 3rd floor-14 th floor (100% completed), 15th floor: 100% completed.
  • slab work – BF to 21st(machine room ) (100% completed)
  • Retaining wall -100% completed
  • LT Electrical work – upto 5 th floor (70% completed )
  • Water Proofing Work : 1, 2, 3, 4th, 5th, 6th floor -70% completed.

As per the current work status from our site, we are targeted to complete the following works by the end of JANUARY 2020

  • Block work – 15,16th floor (100 % to be completed)
  • Ceiling Plastering work -15th-16th floor – 100% to be completed
  • Roof slab work – (machine room ) roof slab (100% to be completed)
  • LT Electrical work – upto 7th floor (70% )to be completed
  • Water Proofing Work : 6th,7 th floor -70% to be completed.

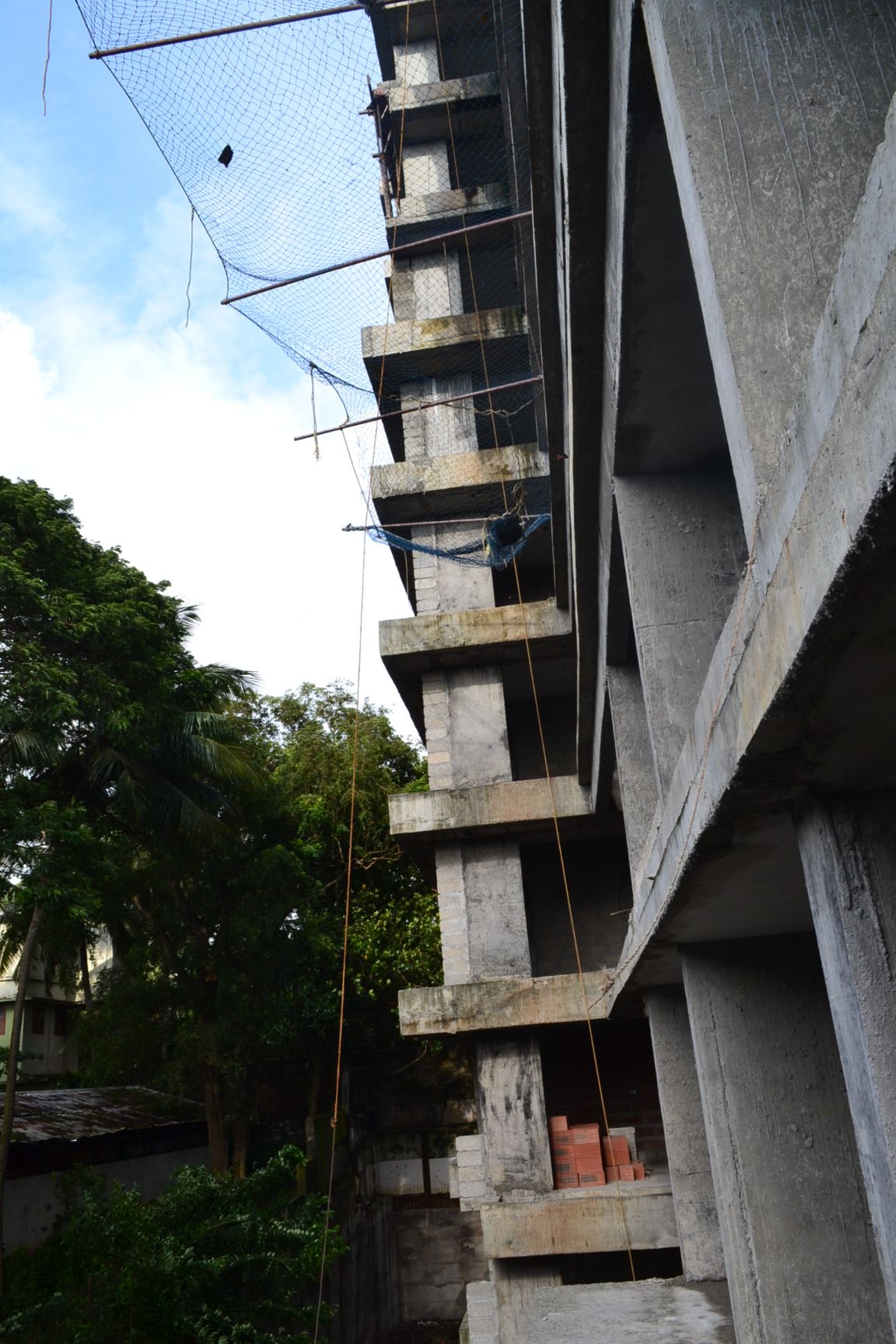

Work status as on 10-01-2020, we have completed the following.

  • Piling work – 100% completed
  • Pile chipping work – 100% completed
  • Pile cap work – 100% completed
  • BF column work – 100% completed
  • Block work – 1st floor,3rd -14 th floor (100%completed); 2nd floor( 70% completed).
  • Ceiling Plastering work -Gf -70%,1 st floor -70%, 2nd floor (100% completed); 3rd floor-14 th floor (100% completed)
  • slab work – BF to 21st(machine room ) (50% completed)
  • Retaining wall -100% completed
  • LT Electrical work – upto 5 th floor (50% completed )
  • Water Proofing Work : 1,2,3 ,4 th ,5th floor -70% completed.

As per the current work status from our site we are targeted to complete the following works by end of September 2019

  • Block work – ,12 th floor (100 % to be completed)
  • Ceiling Plastering work -13th floor – 100% to be completed
  • Roof slab work – 19th floor -100% to be completed
  • Water Proofing Work : 5th floor -50% to be completed.

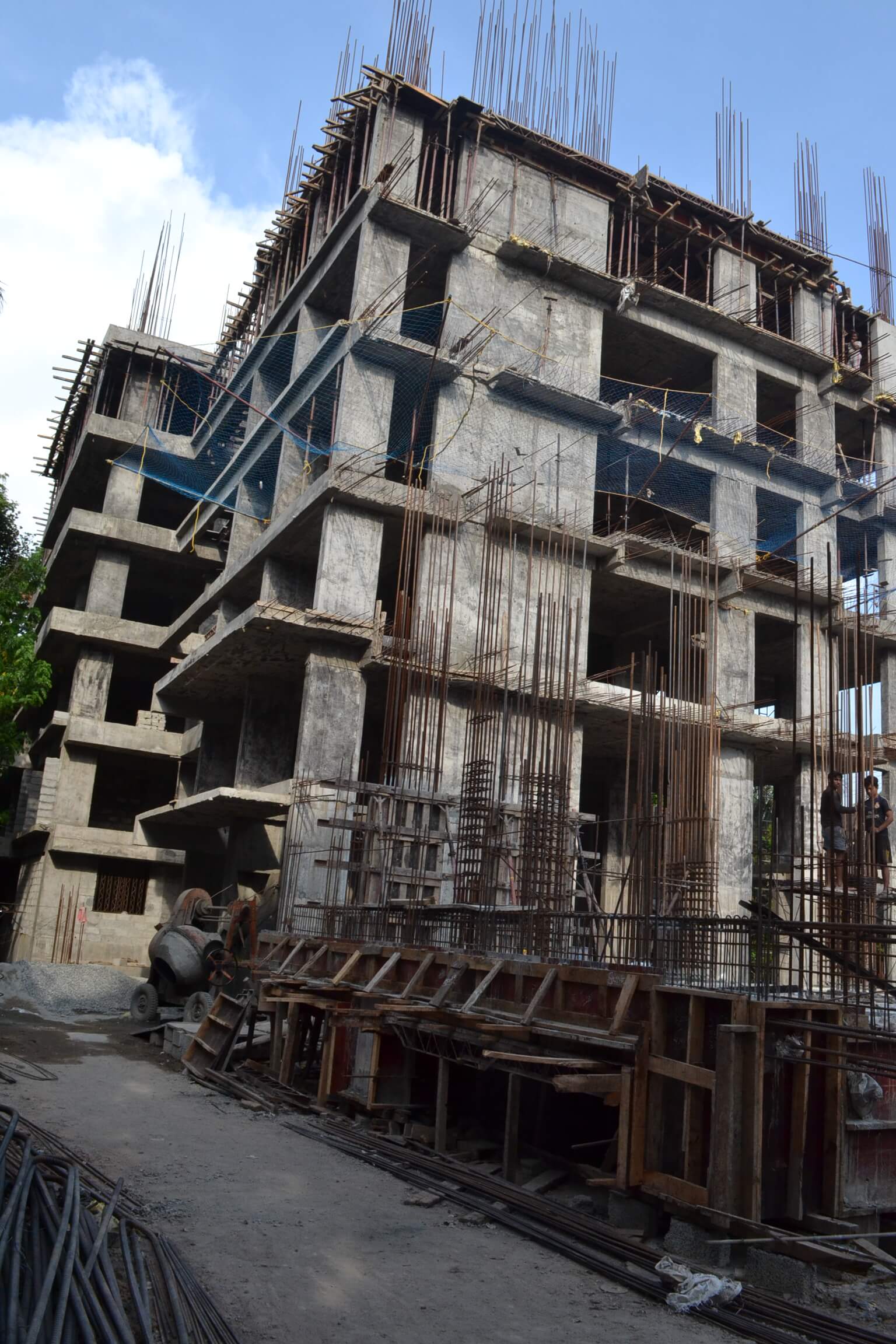

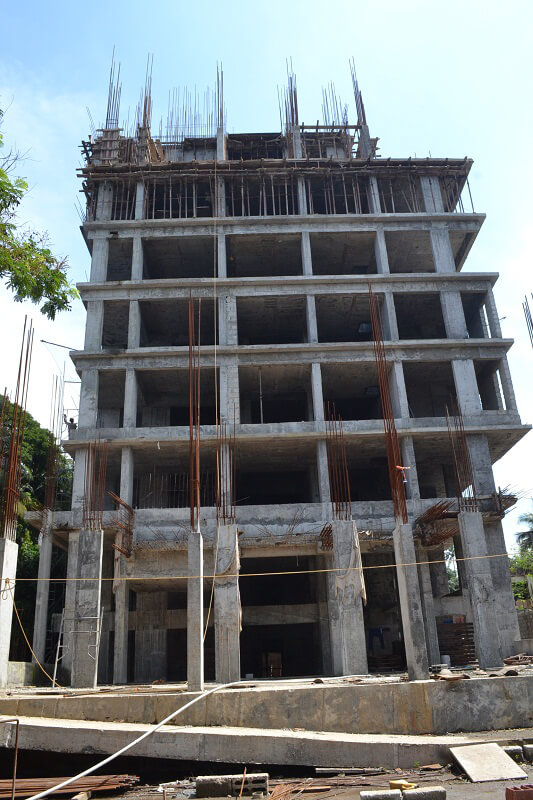

Work status as on 05.09.2019, we have completed the following

  • Piling work – 100% completed
  • Pile chipping work – 100% completed
  • Pile cap work – 100% completed
  • BF column work – 100% completed
  • Block work – 1st floor (100%completed); 2nd floor( 70% completed); 3rd floor (100% completed); 4th floor (100% completed);5th floor(100% completed),6th floor(100% completed),7th floor(70% completed),8th floor(100% completed),9 th floor -(100% completed),10th -70% completed ,11 th floor (100% completed)
  • Ceiling Plastering work -Gf -70%,1 st floor -70%, 2nd floor (100% completed); 3rd floor (100% completed),4 th floor-100% completed, 5 th -100%completed,6 th -100%completed, 7th floor – 100% to be completed,, 8th floor – 100% completed,9 th floor -100% completed ,10th -100% completed,11 th -100% completed,12 th-100% to be completed
  • slab work – BF to 1st floor (100% completed); 2nd floor (90% completed); 3rd floor (completed) ; 4th to 6th floor (completed); 7th floor (100% completed); 8th floor (100% completed); 9th floor (100% completed); 10th floor (100% completed),11 floor -100%completed,12floor -100%completed,13floor -100%completed,14floor -completed,15 th floor -completed,16 th floor -100% completed.,17 th floor -100% completed,18 th floor -100% completed
  • Retaining wall -100% completed
  • Water Proofing Work : 1,2,3 ,4 th floor -50% completed.

As per the current work status from our site we are targeted to complete the following works by end of August 2019

  • Block work – ,10 th &11 th floor (100 % to be completed)
  • Ceiling Plastering work -11th floor – 100% to be completed
  • Roof slab work – 18th floor -100% to be completed
  • Column work -18th-19th floor column work-50% completed

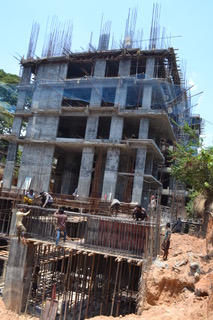

Work status as on 05.08.2019, we have completed the following

  • Piling work – 100% completed
  • Pile chipping work – 100% completed
  • Pile cap work – 100% completed
  • BF column work – 100% completed
  • Block work – 1st floor (100%completed); 2nd floor( 70% completed); 3rd floor (100% completed); 4th floor (100% completed);5th floor(100% completed),6th floor(100% completed),7th floor(70% completed),8th floor(100% completed),9 th floor -(70% completed),10th -50% completed ,11 th floor (50% completed)
  • Ceiling Plastering work -Gf -70%,1 st floor -70%, 2nd floor (100% completed); 3rd floor (100% completed),4 th floor-100% completed, 5 th -100%completed,6 th -100%completed, 7th floor – 100% to be completed,, 8th floor – 100% completed,9 th floor -100% completed ,10th -100% completed,11 th -50% completed.
  • Roof slab work – BF to 1st floor (100% completed); 2nd floor (90% completed); 3rd floor (completed) ; 4th to 6th floor (completed); 7th floor (100% completed); 8th floor (100% completed); 9th floor (100% completed); 10th floor (100% completed),11 floor -100%completed,12floor -100%completed,13floor -100%completed,14floor -completed,15 th floor -completed,16 th floor -100% completed.,17 th floor -100% completed
  • Retaining wall -100% completed
  • Water Proofing Work : 1,2,3 rd floor -50% completed.

As per the current work status from our site we are targeted to complete the following works by end of July 2019

  • Block work – 11 th floor (100 % to be completed)
  • Ceiling Plastering work -11th floor – 100% to be completed
  • Roof slab work – 16th floor -100% to be completed

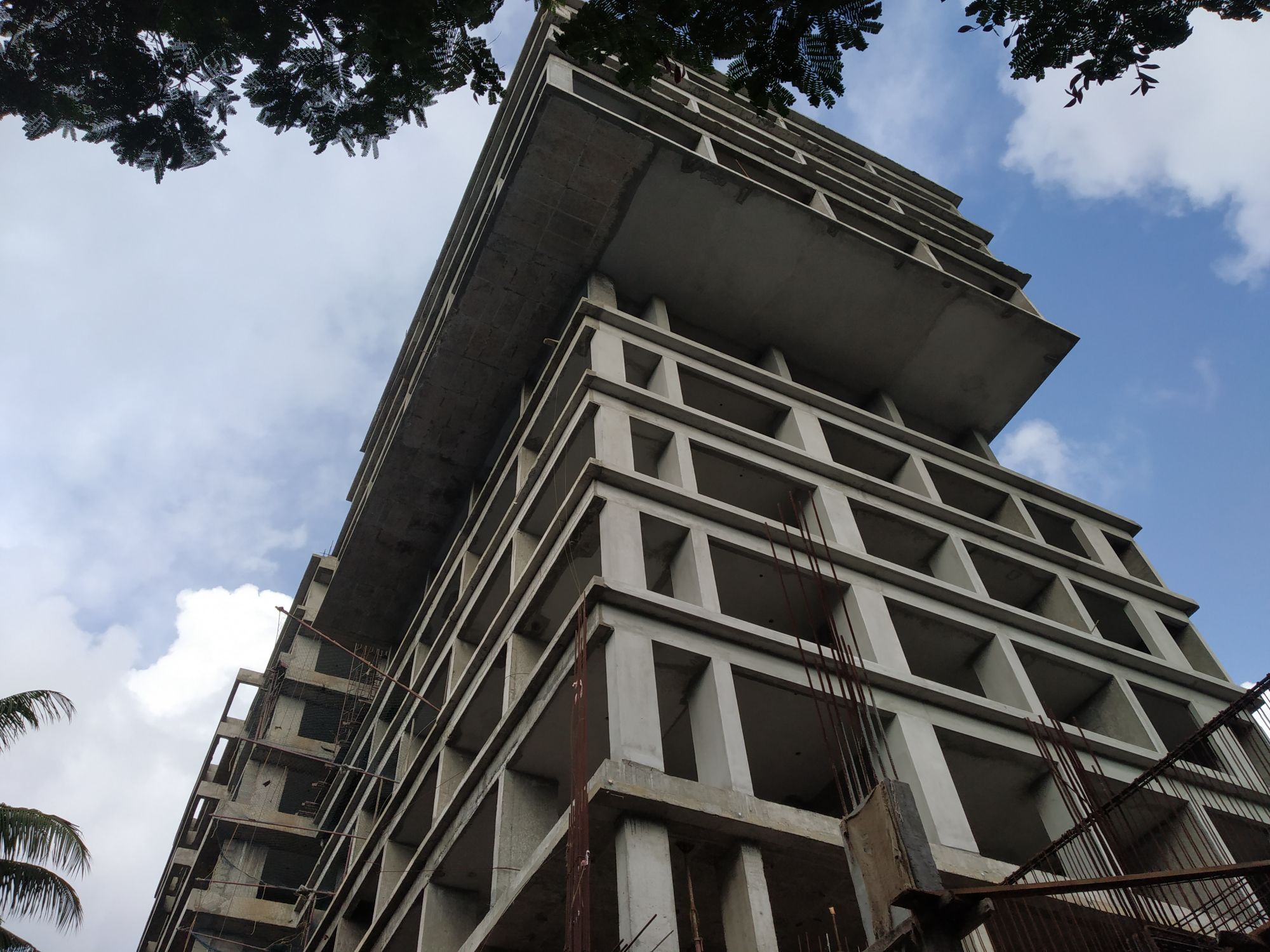

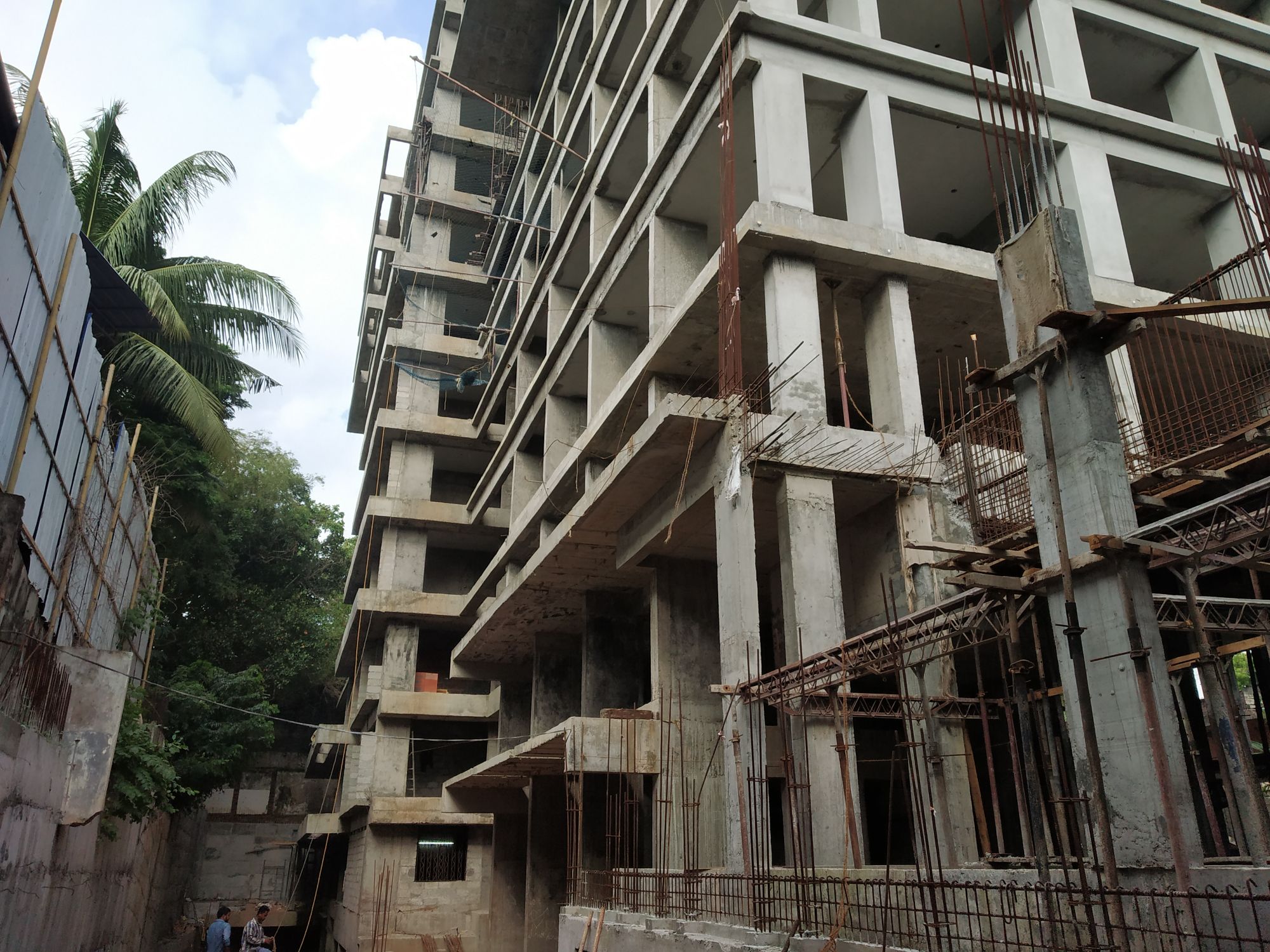

Work status as on 06.07.2019, we have completed the following

  • Piling work – 100% completed
  • Pile chipping work – 100% completed
  • Pile cap work – 100% completed
  • BF column work – 100% completed
  • Block work – 1st floor (100%completed); 2nd floor( 70% completed); 3rd floor (100% completed); 4th floor (100% completed);5th floor(100% completed),6th floor(100% completed),7th floor(70% completed),8th floor(100% completed),9 th floor -(70% completed),10th -30% completed ,11 th floor (50% completed)
  • Ceiling Plastering work – 2nd floor (60% completed); 3rd floor (100% completed),4 th floor-100% completed, 5 th -100%completed,6 th -100%completed, 7th floor – 100% to be completed,, 8th floor – 100% completed,9 th floor -100% completed ,10th -100% completed,11 th -50% completed.

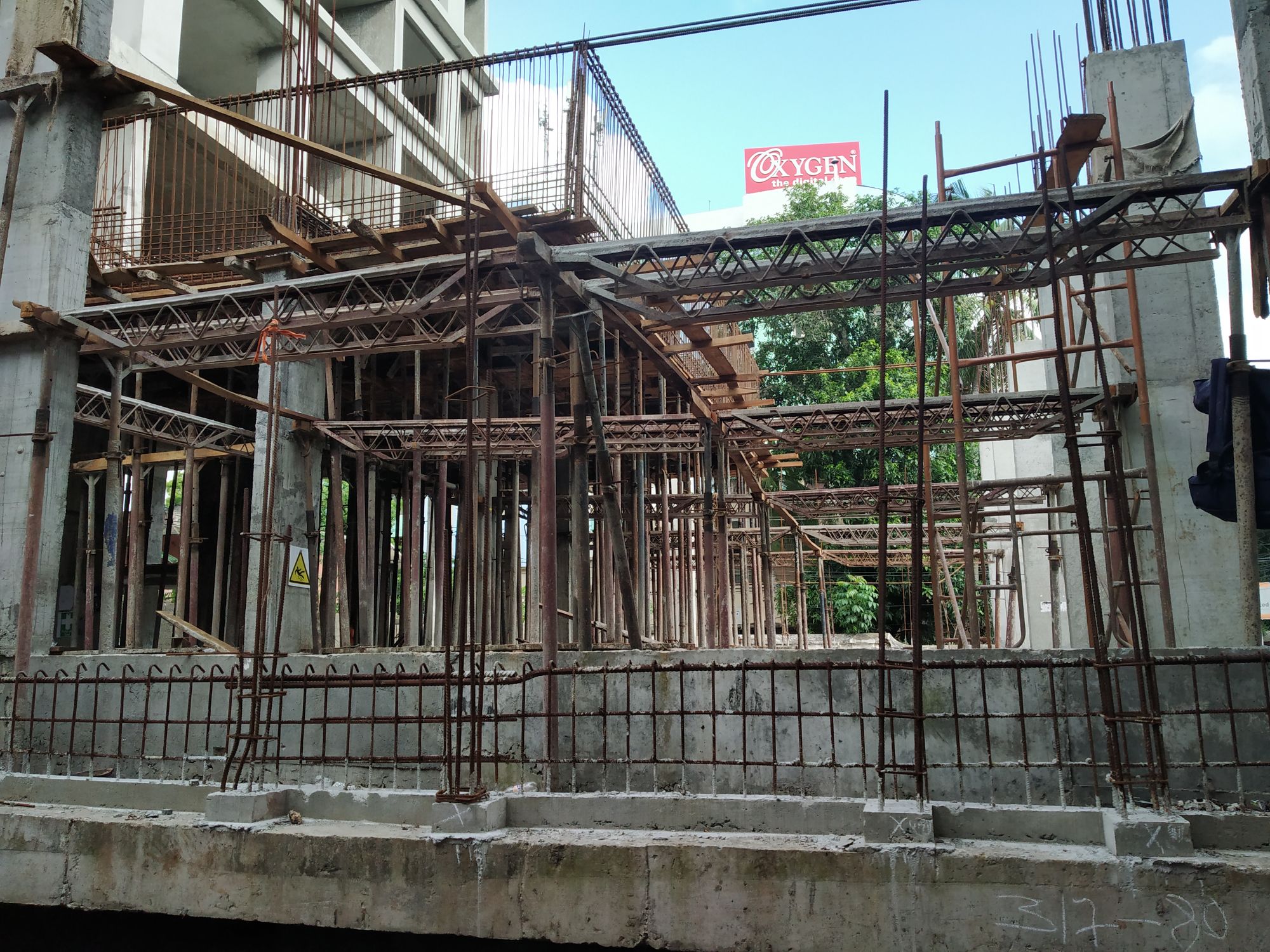

  • Roof slab work – BF to 1st floor (100% completed); 2nd floor (90% completed); 3rd floor (completed) ; 4th to 6th floor (completed); 7th floor (100% completed); 8th floor (100% completed); 9th floor (100% completed); 10th floor (100% completed),11 floor -100%completed,12floor -100%completed,13floor -100%completed,14floor -completed,15 th floor -completed,16 th floor -100% completed.
  • Retaining wall -100% completed
  • Column work -16th-17 th floor column work-50% completed
  • Water Proofing Work : On progressing

As per the current work status from our site we are targeted to complete the following works by end of June 2019

  • Block work – 11 th floor (100 % to be completed)
  • Ceiling Plastering work -11th floor – 100% to be completed
  • Roof slab work – 16th floor -100% to be completed
  • Retaining wall -100% to be completed

Work status as on 06.06.2019, we have completed the following

  • Piling work – 100% completed
  • Pile chipping work – 100% completed
  • Pile cap work – 100% completed
  • BF column work – 100% completed
  • Block work – 1st floor (100%completed); 2nd floor( 70% completed); 3rd floor (100% completed); 4th floor (100% completed);5th floor(100% completed),6th floor(100% completed),7th floor(70% completed),8th floor(100% completed),9 th floor -(70% completed),11 th floor (50% completed)
  • Ceiling Plastering work – 2nd floor (60% completed); 3rd floor (100% completed),4 th floor-100% completed, 5 th -100%completed,6 th -100%completed, 7th floor – 100% to be completed,, 8th floor – 100% completed,9 th floor -100% completed ,10th -100% completed
  • Roof slab work – BF to 1st floor (100% completed); 2nd floor (90% completed); 3rd floor (completed) ; 4th to 6th floor (completed); 7th floor (100% completed); 8th floor (100% completed); 9th floor (100% completed); 10th floor (100% completed),11 floor -100%completed,12floor -100%completed,13floor -100%completed,14floor -completed,15 th floor -completed,16 th floor -shuttering work on progress
  • Retaining wall -80% completed
  • Column work -15 th -16 th floor column work completed

As per the current work status from our site we are targeted to complete the following works by end of May 2019

  • Block work – 9th floor & 11 th floor (100 % to be completed)
  • Ceiling Plastering work -11th floor – 100% to be completed
  • Roof slab work – 15th floor -100% to be completed
  • Retaining wall -100% to be completed
  • Column work -column work -100% completed.

Work status as on 06.05.2019, we have completed the following

  • Piling work – 100% completed
  • Pile chipping work – 100% completed
  • Pile cap work – 100% completed
  • BF column work – 100% completed
  • Block work – 1st floor (100%completed); 2nd floor( 70% completed); 3rd floor (100% completed); 4th floor (100% completed);5th floor(100% completed),6th floor(100% completed),7th floor(70% completed),8th floor(100% completed),9 th floor -(70% completed),11 th floor (50% completed)
  • Ceiling Plastering work – 2nd floor (60% completed); 3rd floor (100% completed),4 th floor-100% completed, 5 th -100%completed,6 th -100%completed, 7th floor – 100% to be completed,, 8th floor – 100% completed,9 th floor -100% completed
  • Roof slab work – BF to 1st floor (100% completed); 2nd floor (90% completed); 3rd floor (completed) ; 4th to 6th floor (completed); 7th floor (100% completed); 8th floor (100% completed); 9th floor (100% completed); 10th floor (100% completed),11 floor -100%completed,12floor -100%completed,13floor -100%completed,14floor -completed
  • Retaining wall -80% completed
  • Column work -14 to 15 th floor column rising work -on progressing

As per the current work status from our site we are targeted to complete the following works by end of April 2019

  • Block work – 9th floor 50% to be completed.
  • Ceiling Plastering work -9th floor – 100% to be completed
  • Roof slab work – 14th floor -100% to be completed
  • Retaining wall -100% to be completed
  • Column work -BF-13th floor column work-100%completed

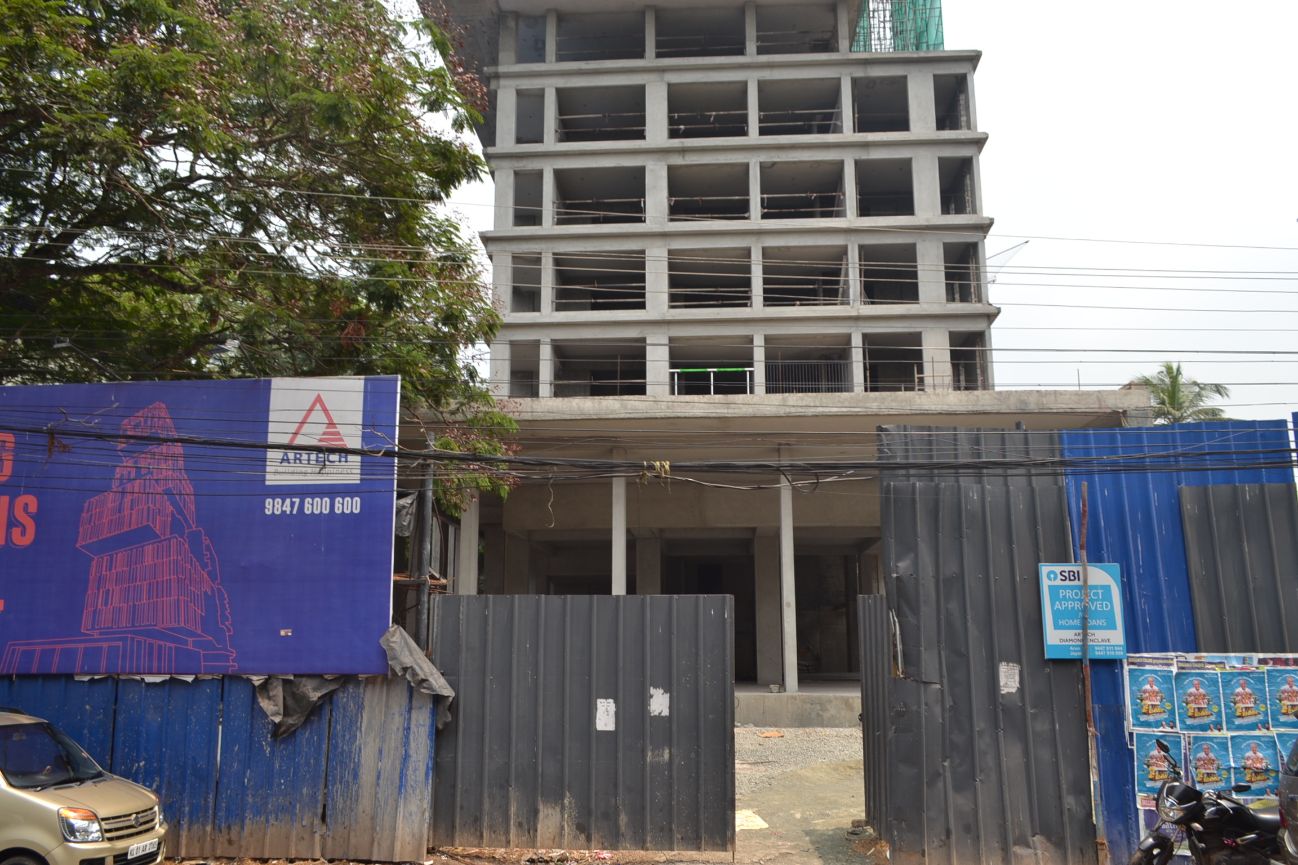

Work status as on 05.04.2019, we have completed the following

  • Piling work – 100% completed
  • Pile chipping work – 100% completed
  • Pile cap work – 100% completed
  • BF column work – 100% completed
  • Block work – 1st floor (100%completed); 2nd floor (60% completed); 3rd floor (75% completed); 4th floor (100% completed);5th floor(100% completed),6th floor(100% completed),7th floor(100% completed),8th floor(50% completed)
  • Ceiling Plastering work – 2nd floor (60% completed); 3rd floor (100% completed),4 th floor-100% completed, 5 th -100%completed,6 th -100%completed, 7th floor – 100% to be completed,, 8th floor – 100% to be completed
  • Roof slab work – BF to 1st floor (100% completed); 2nd floor (90% completed); 3rd floor (completed) ; 4th to 6th floor (completed); 7th floor (100% completed); 8th floor (100% completed); 9th floor (100% completed); 10th floor (100% completed),11 floor -100%completed,12floor -100%completed,13floor -100%completed,14floor -on progressing

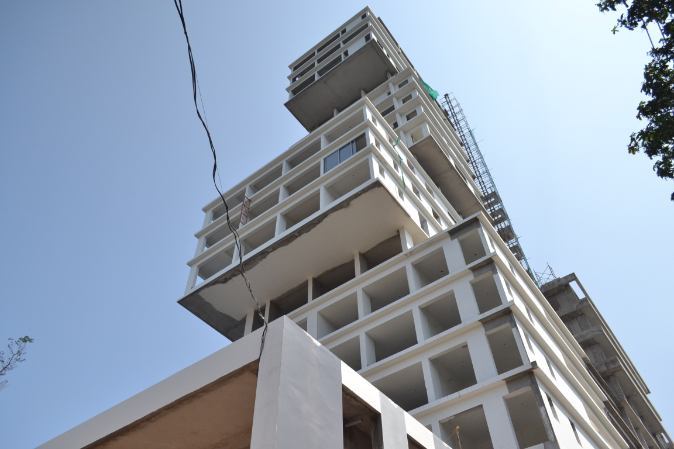

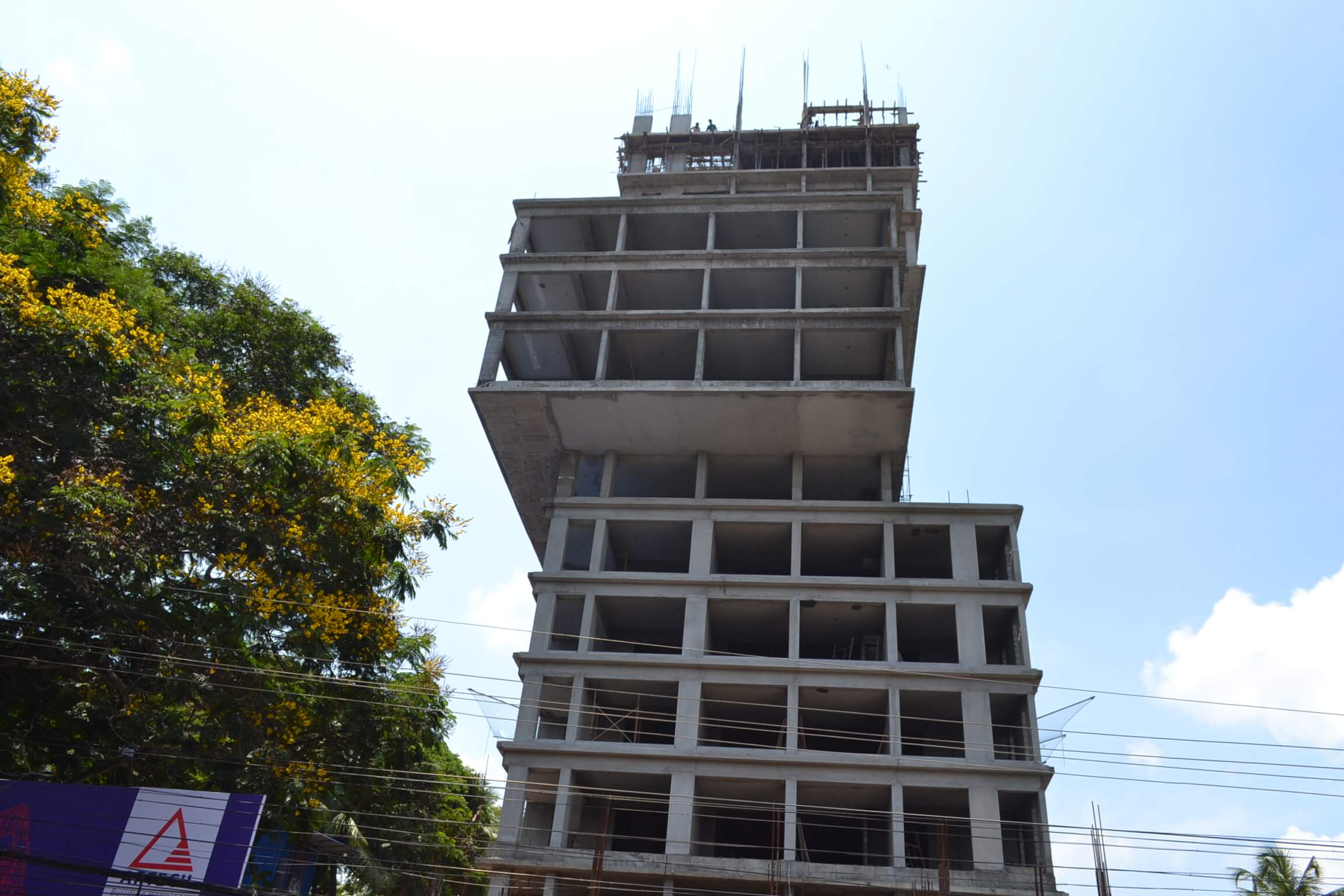

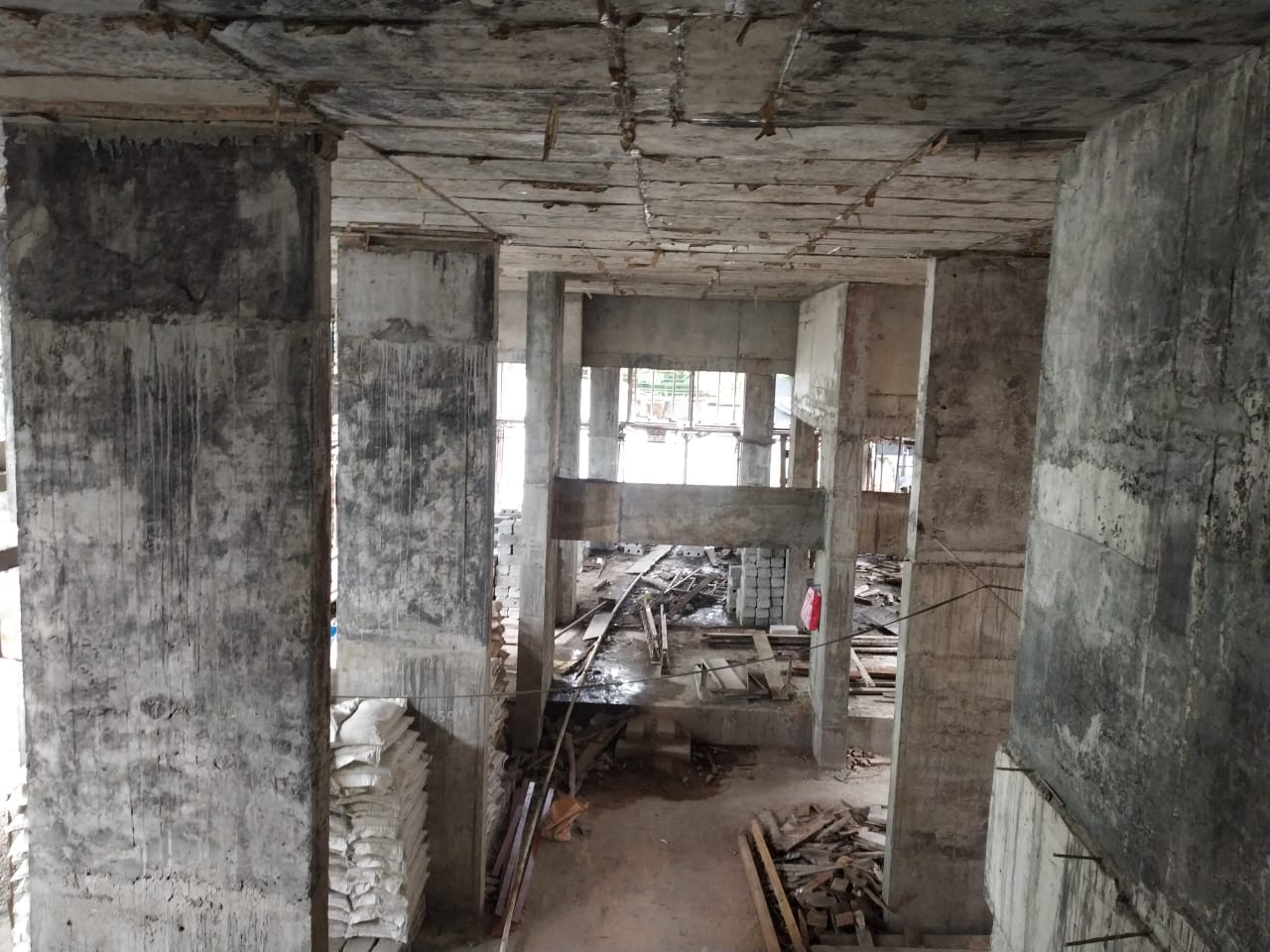

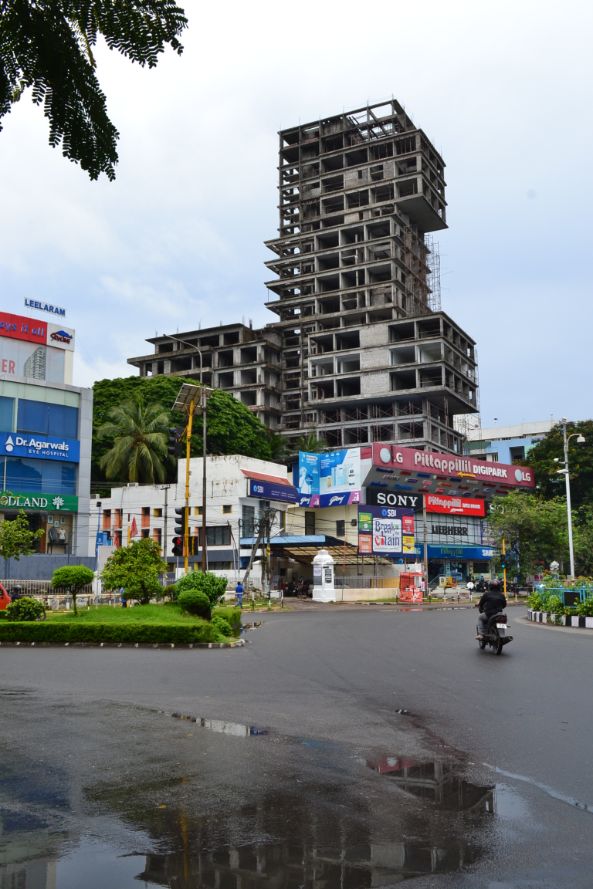

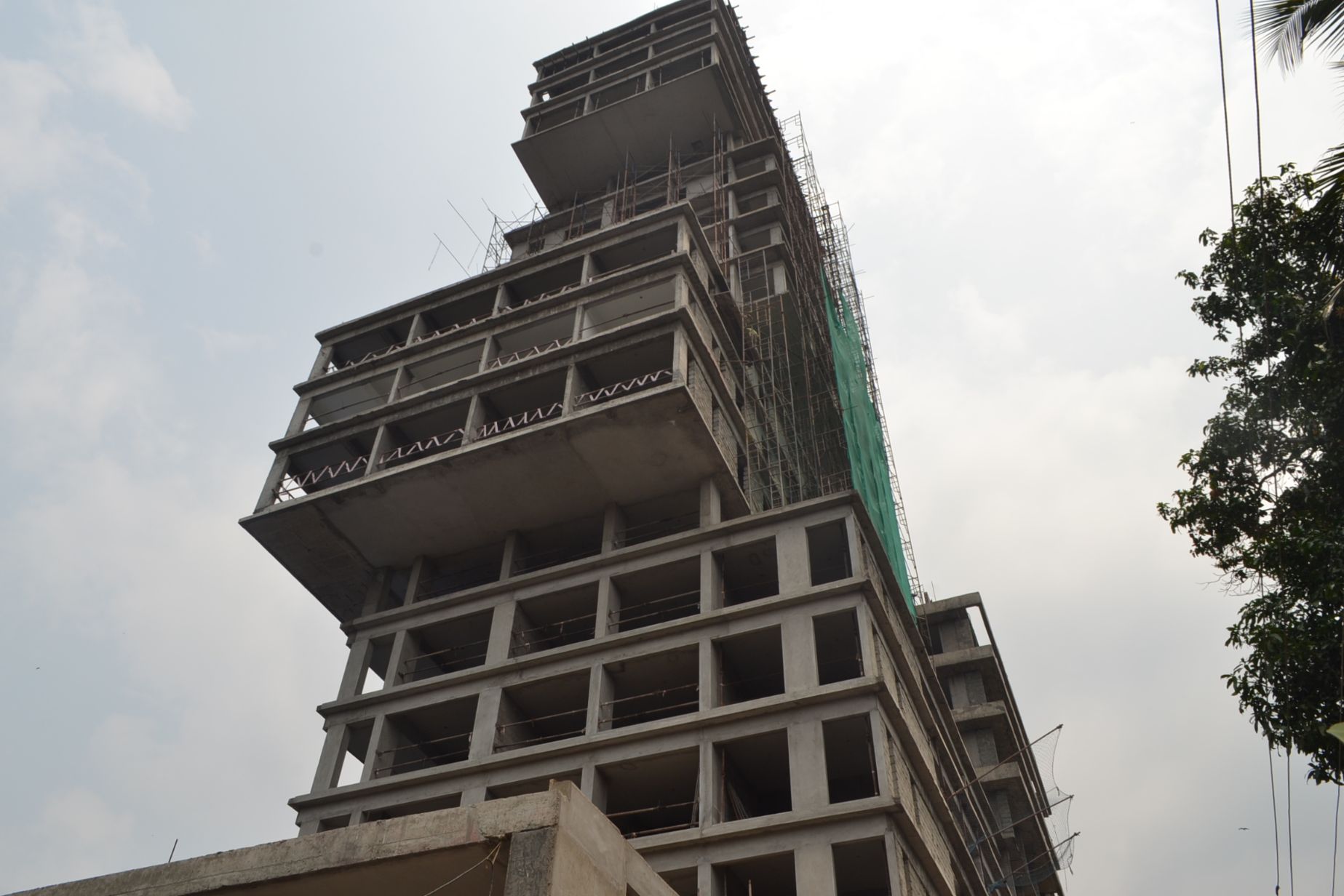

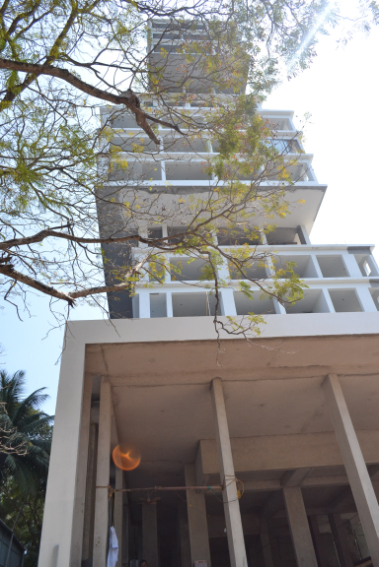

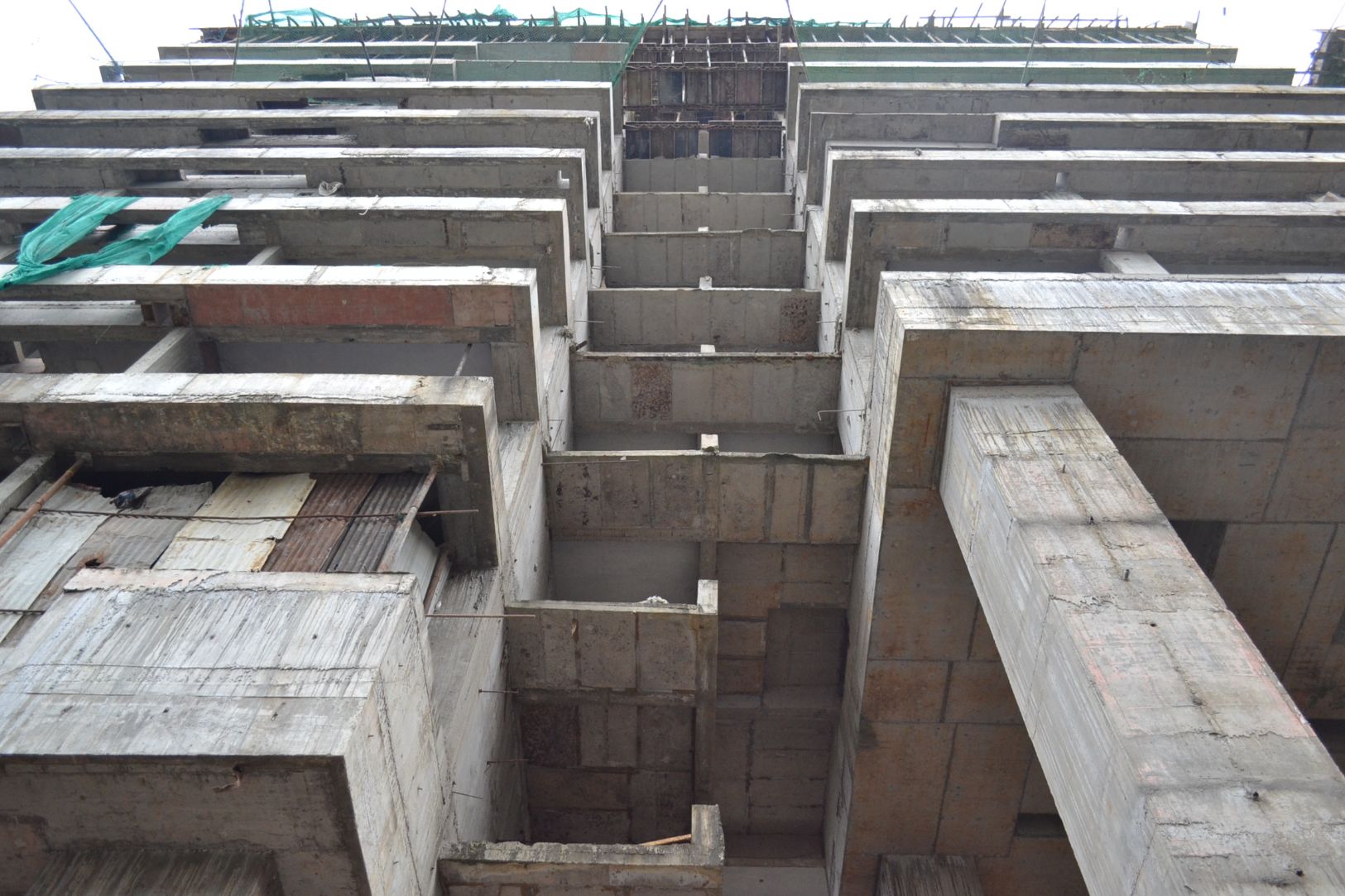

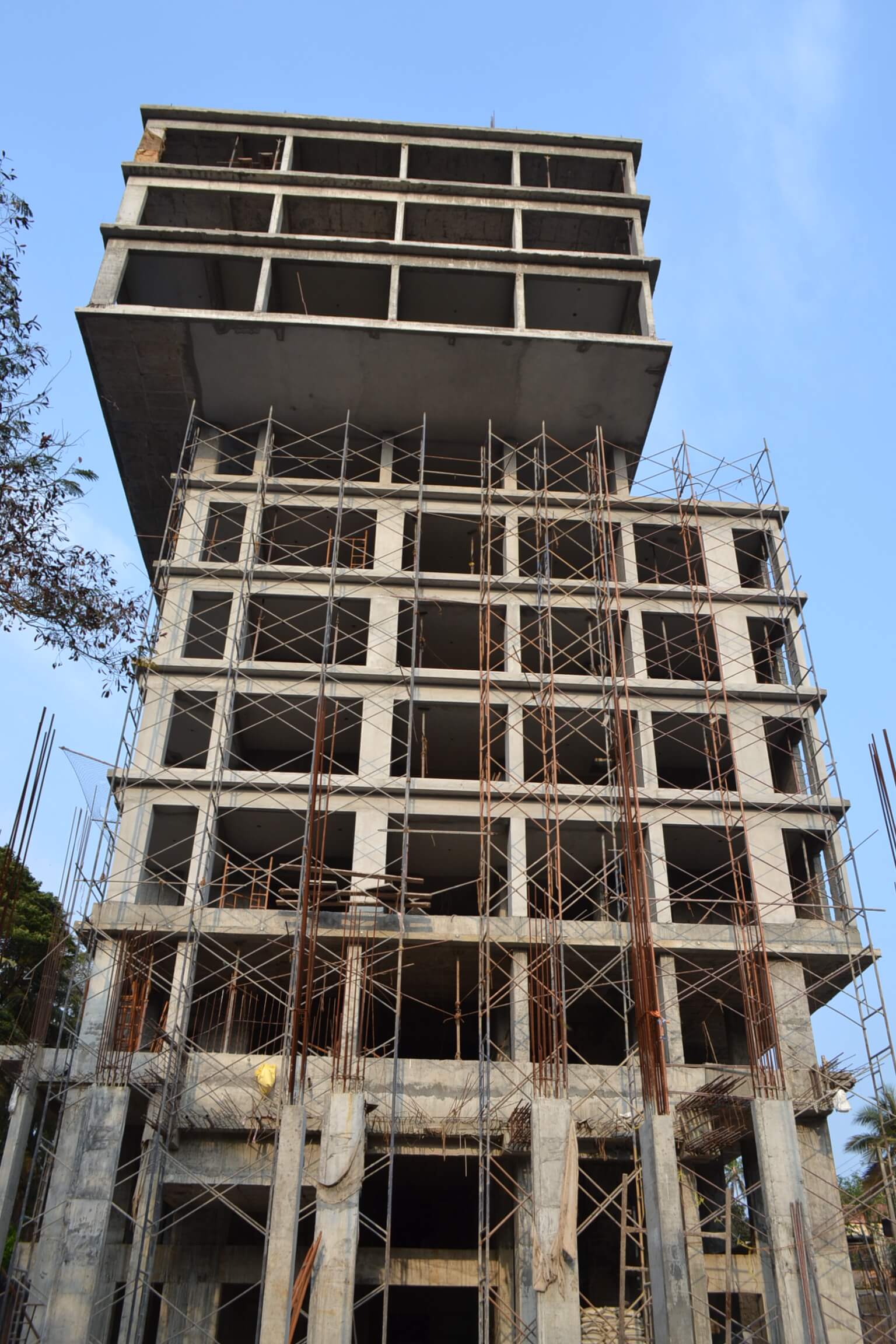

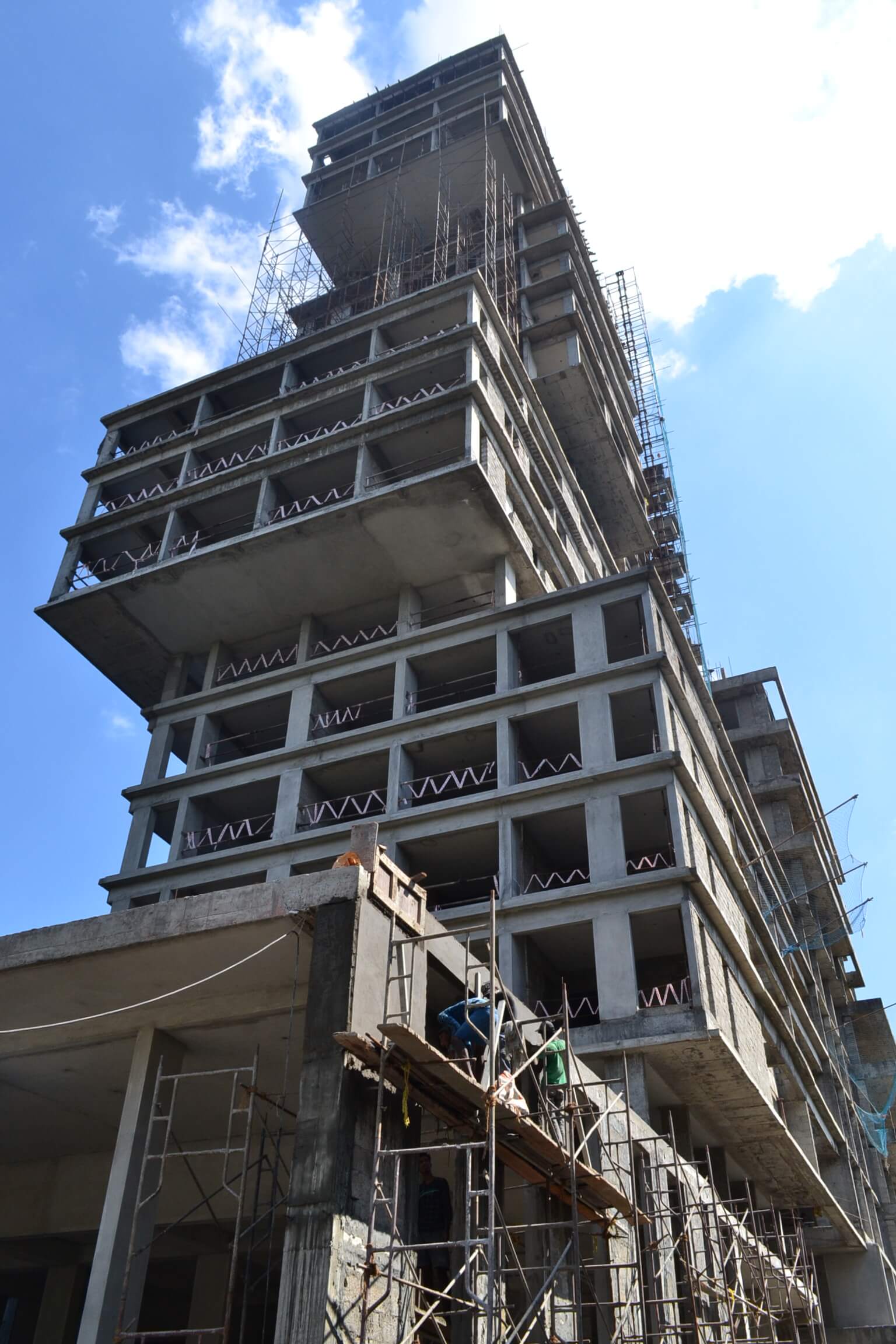

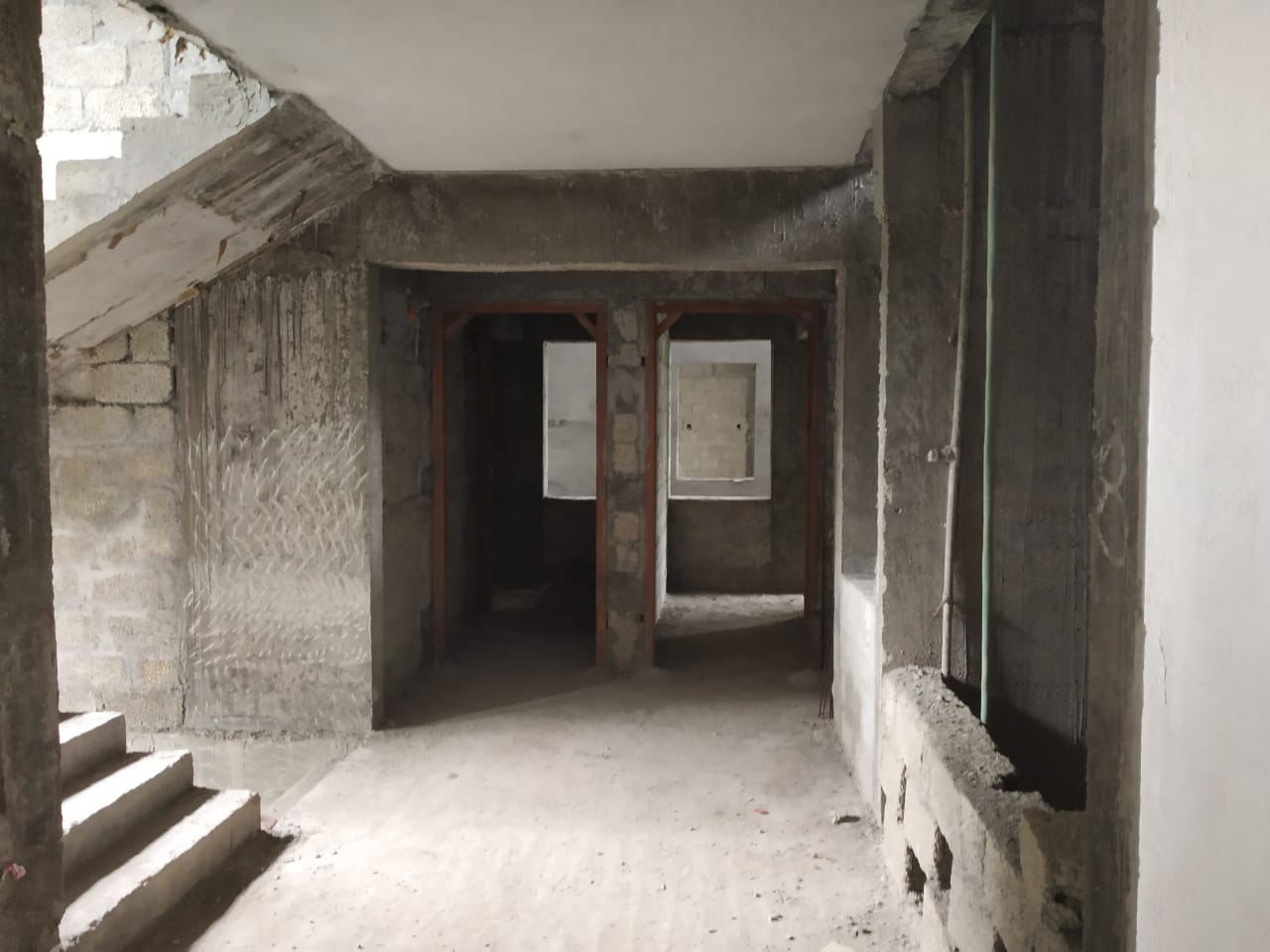

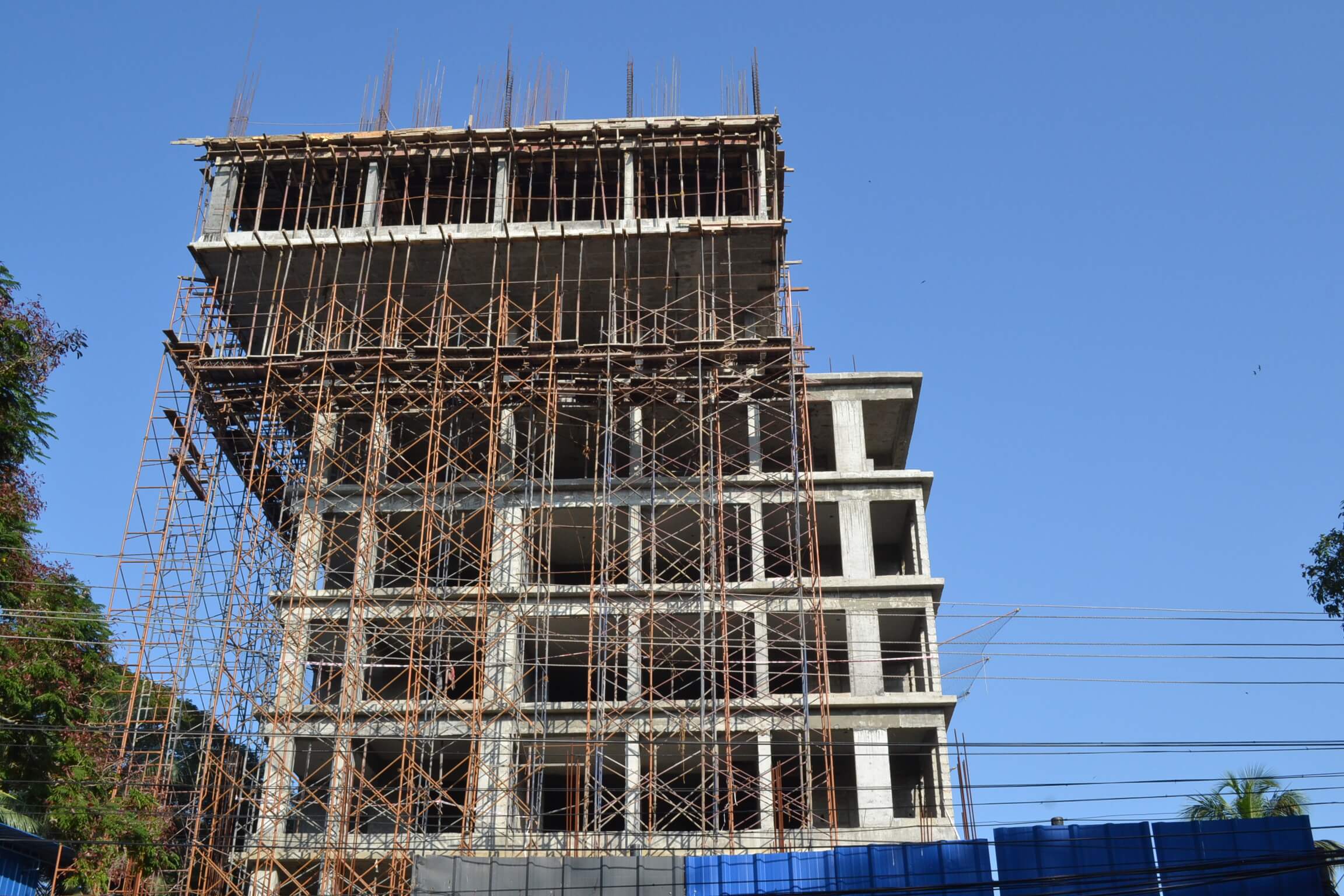

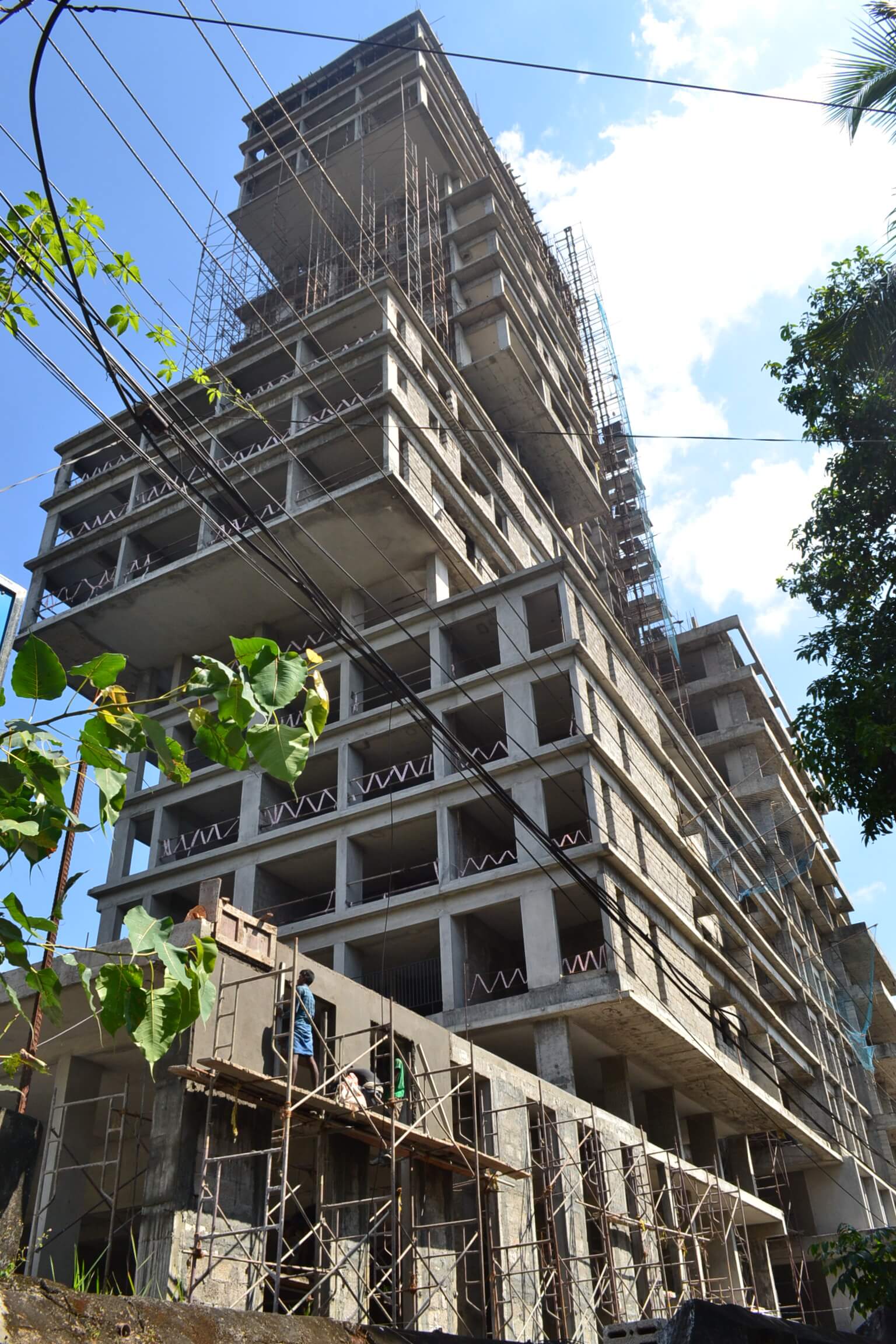

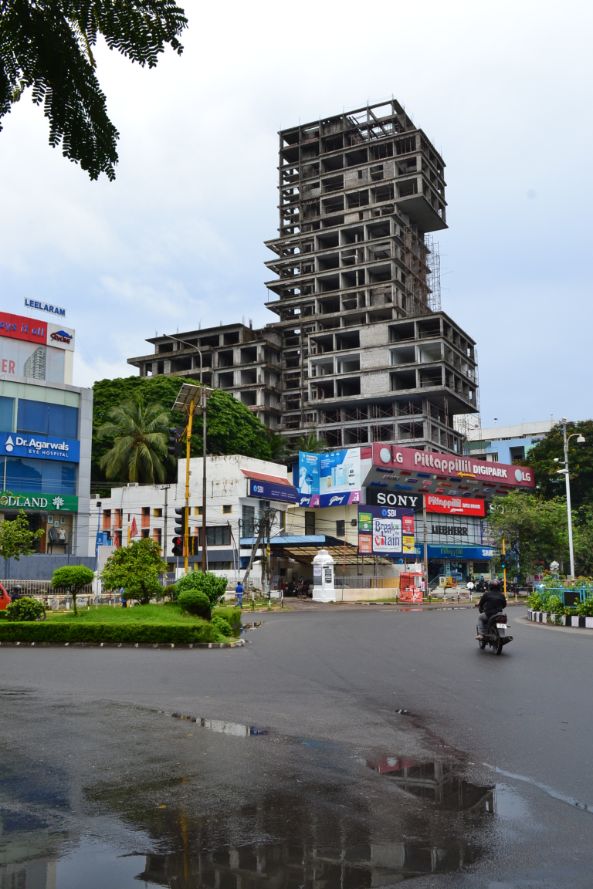

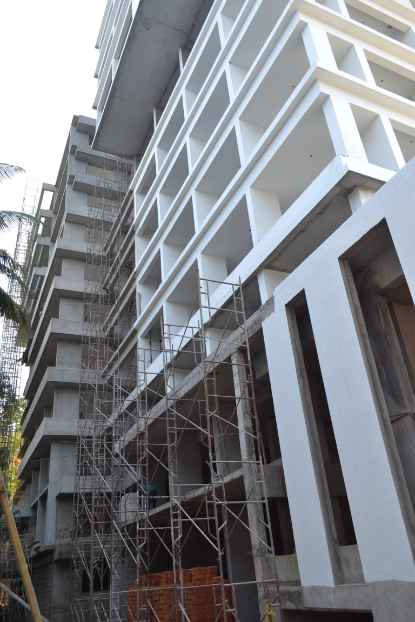

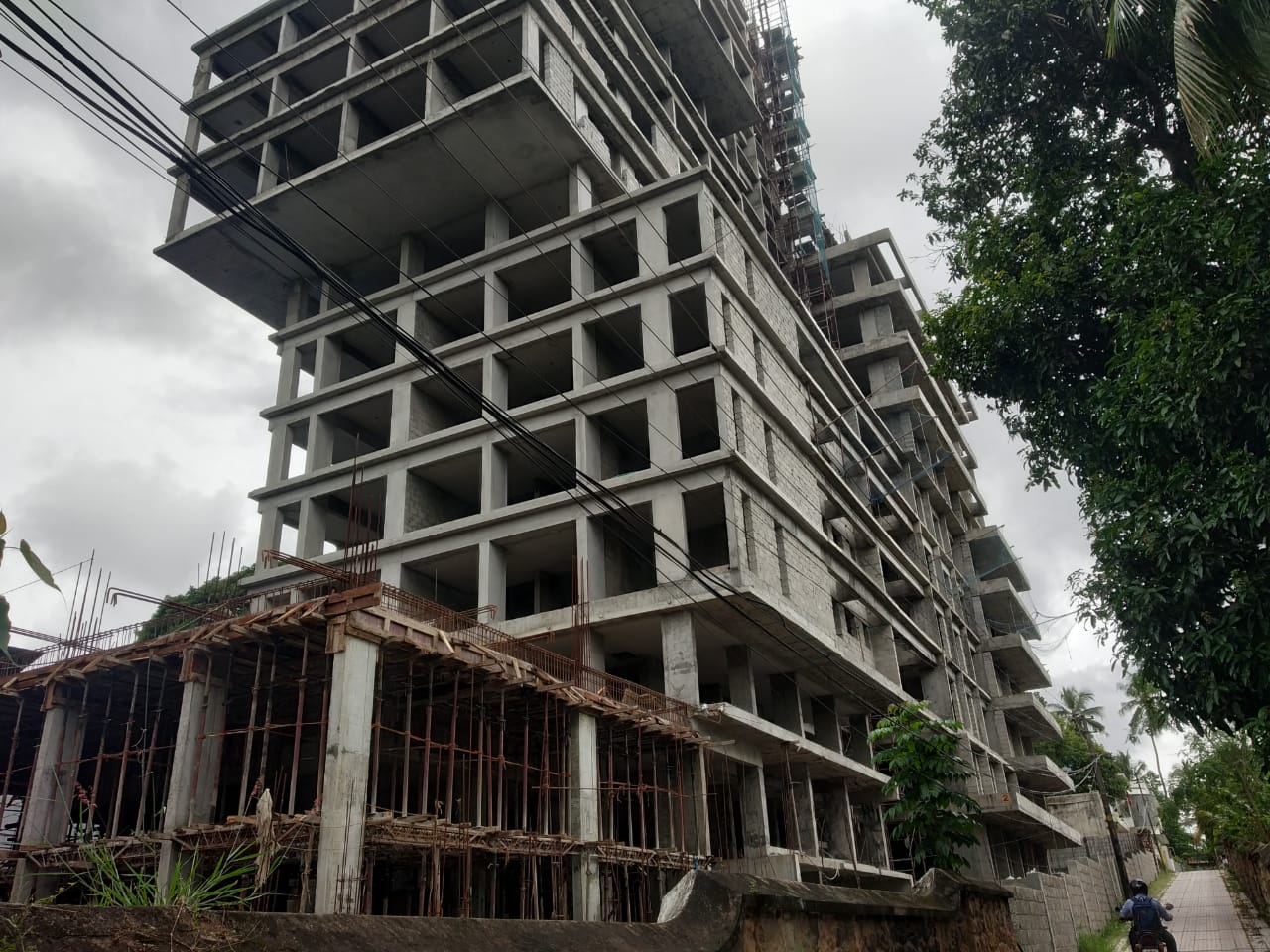

  • Retaining wall -70% completed

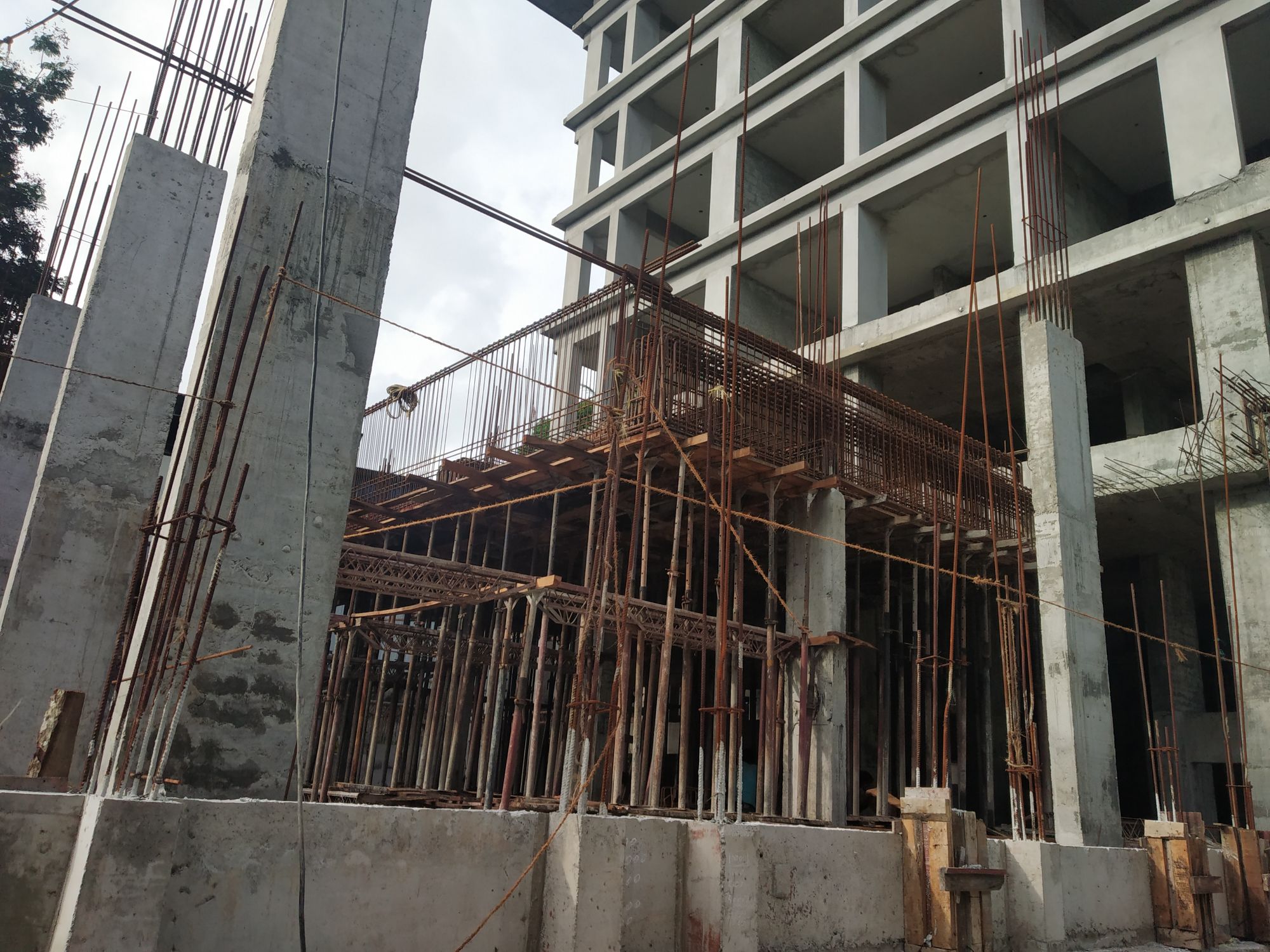

  • Column work -BF-12th floor column work-100%completed

As per the current work status from our site we are targeted to complete the following works by end of March 2019

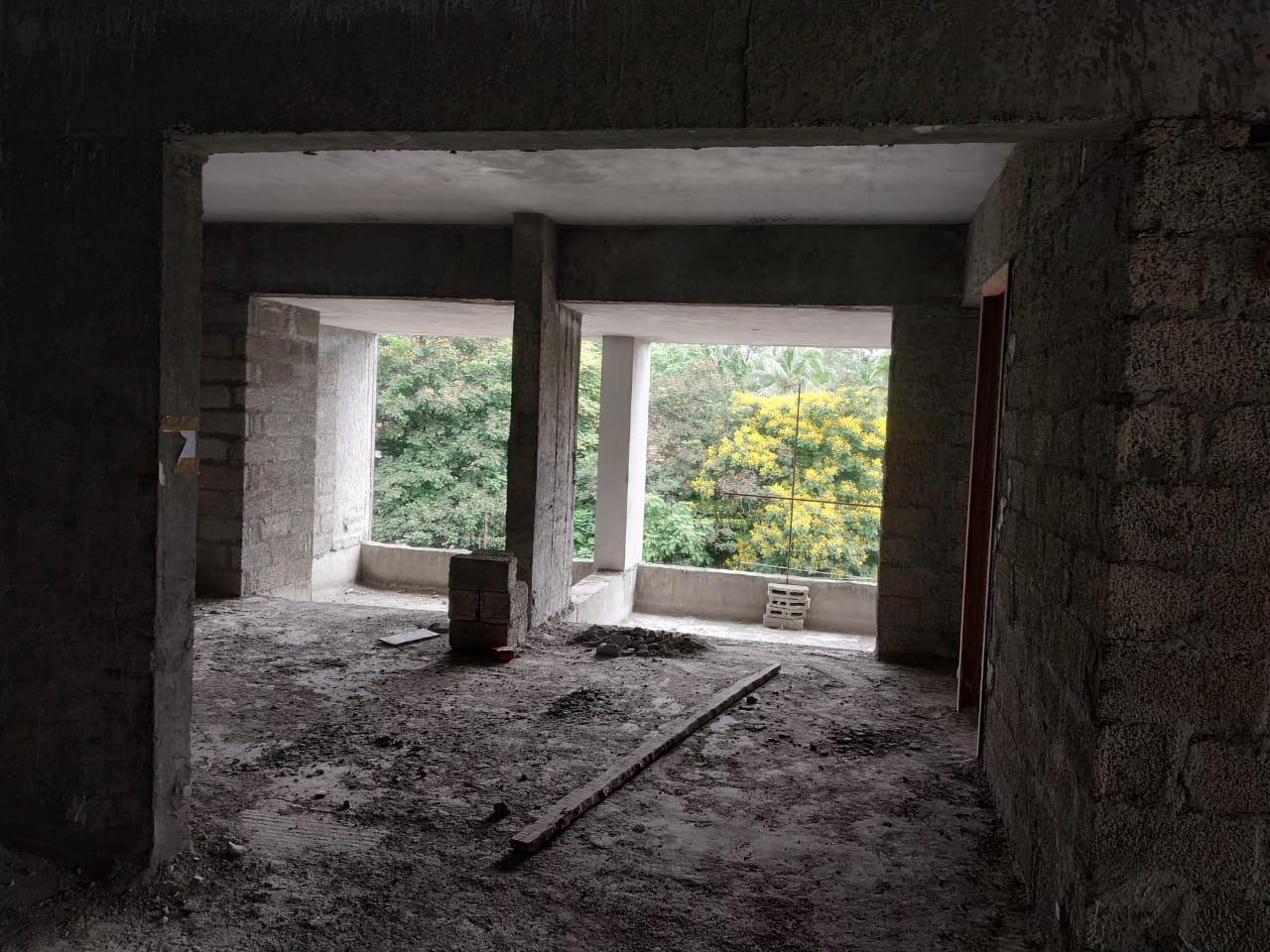

  • Block work – 8th floor 50% to be completed.
  • Ceiling Plastering work -8th floor – 100% to be completed
  • Roof slab work – 13th floor -100% to be completed

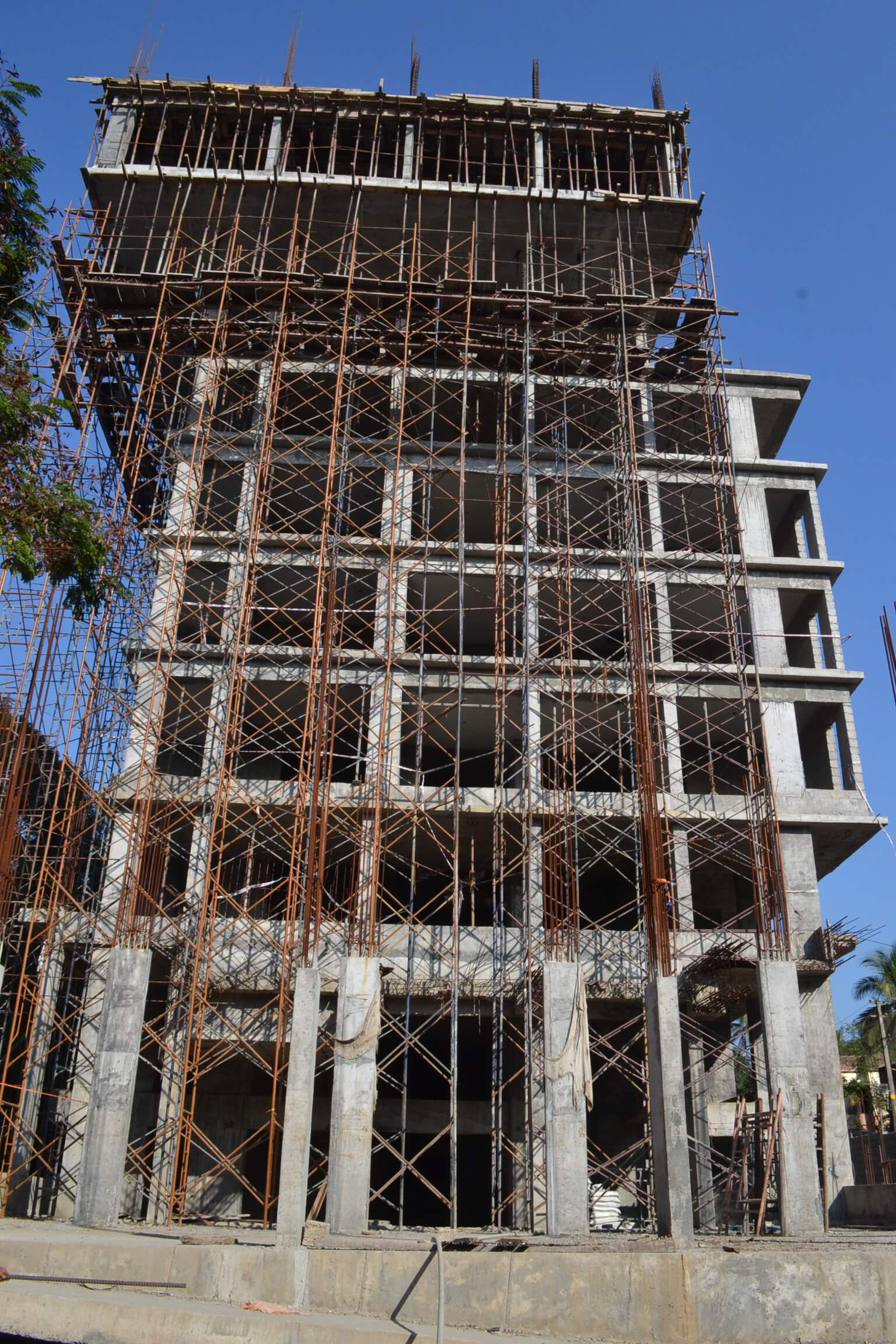

  • Column work -12 th floor column work 100% to be completed

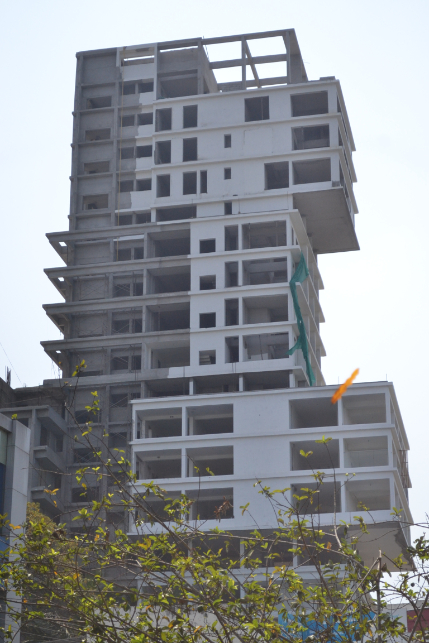

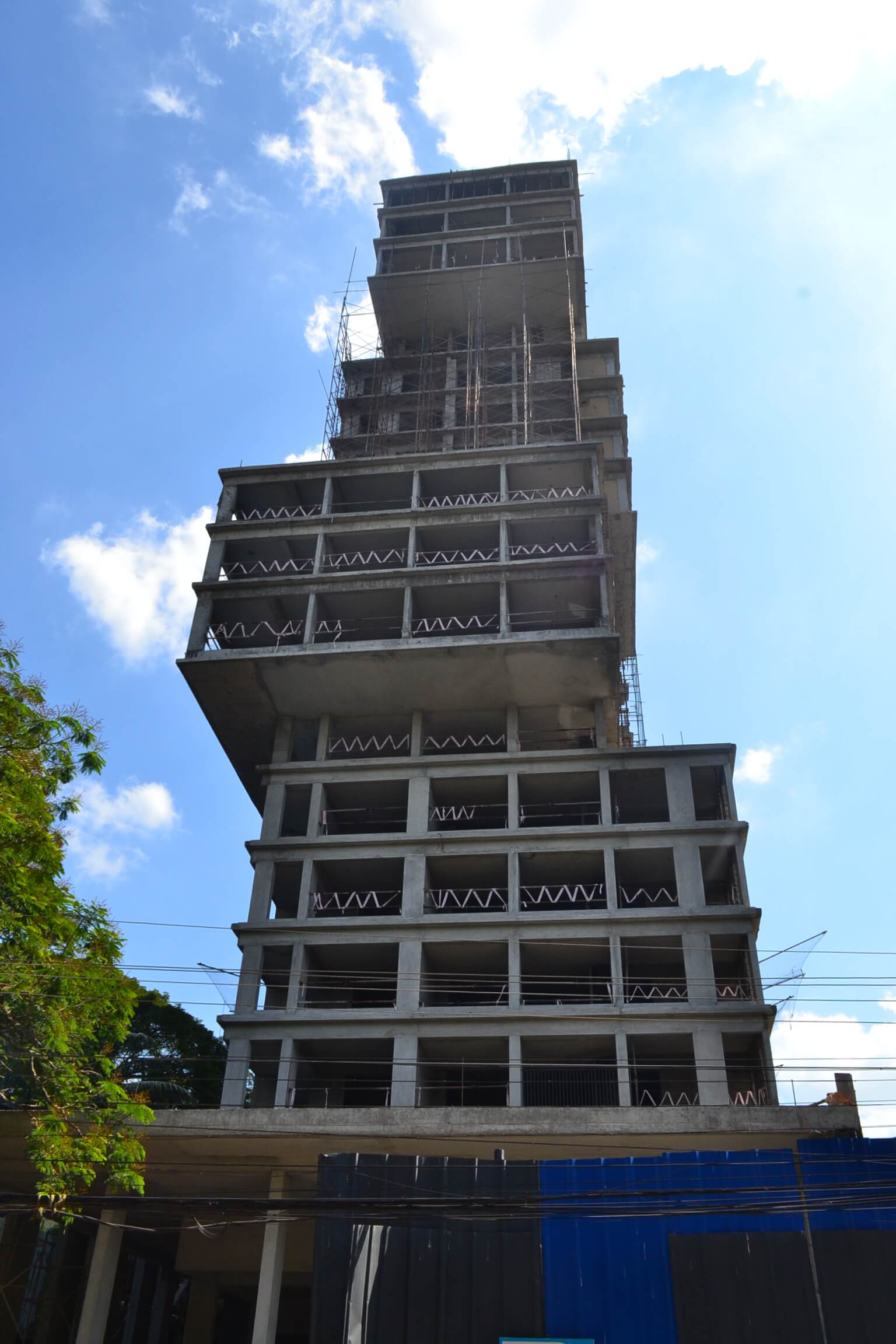

Work status as on 06.03.2019, we have completed the following

  • Piling work – 100% completed
  • Pile chipping work – 100% completed
  • Pile cap work – 100% completed
  • BF column work – 100% completed
  • Block work – 1st floor (100%completed); 2nd floor (60% completed); 3rd floor (75% completed); 4th floor (100% completed);5th floor(100% completed),6th floor(100% completed),7th floor(100% completed)

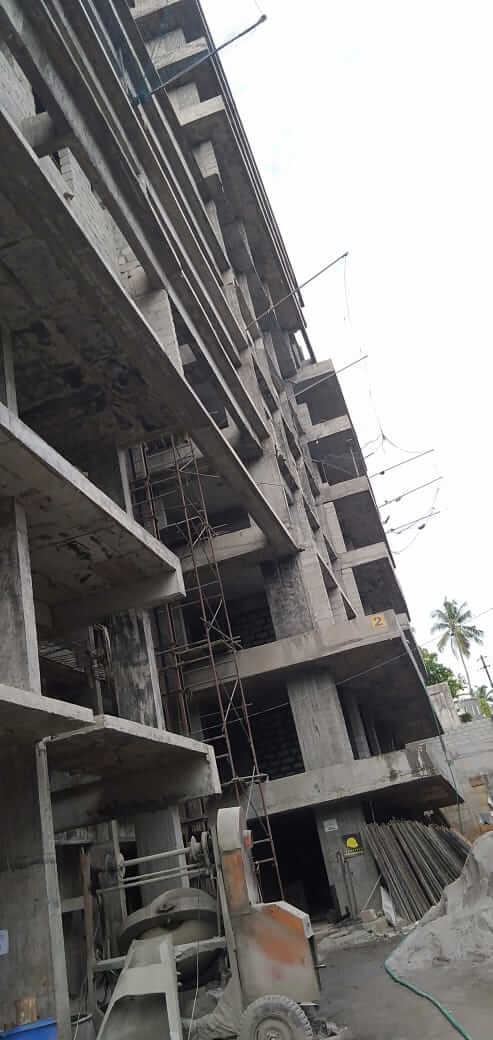

  • Ceiling Plastering work – 2nd floor (60% completed); 3rd floor (100% completed),4 th floor-100% completed, 5 th -100%completed,6 th -100%completed, 7th floor – 100% to be completed

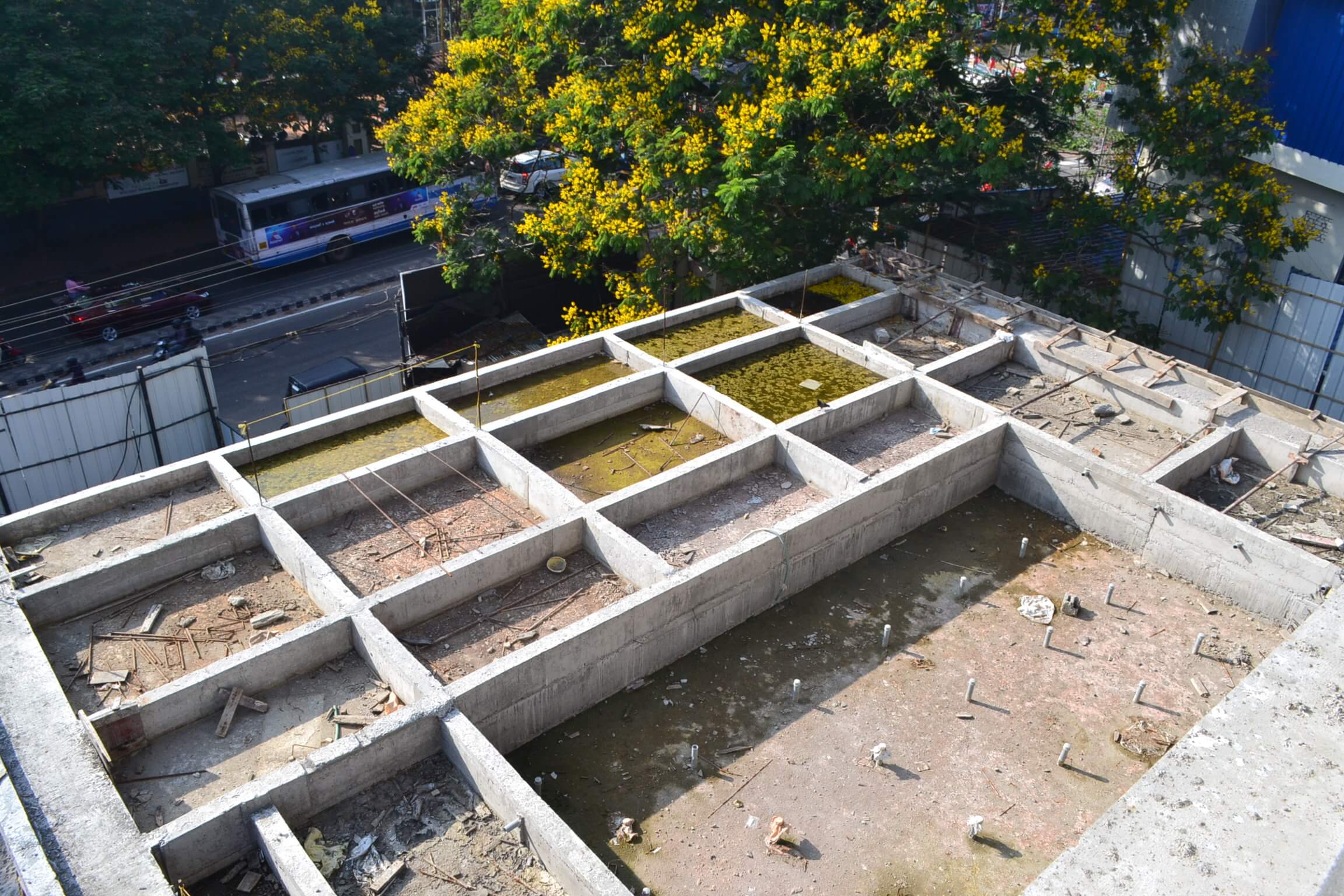

  • Roof slab work – BF to 1st floor (100% completed); 2nd floor (90% completed); 3rd floor (completed) ; 4th to 6th floor (completed); 7th floor (100% completed); 8th floor (100% completed); 9th floor (100% completed); 10th floor (100% completed),11 floor -100%completed,12 floor -100%completed

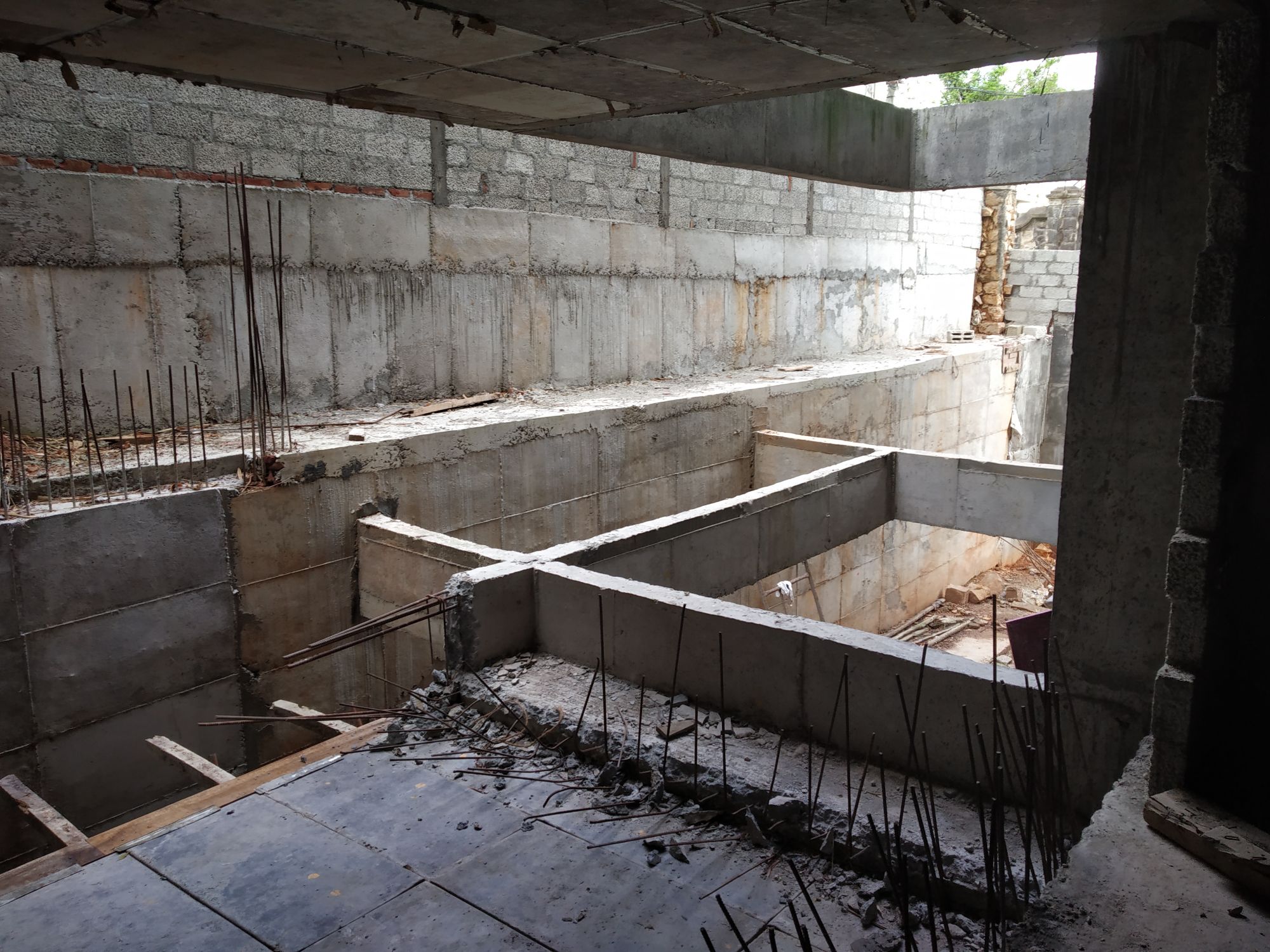

  • Retaining wall -Left side (50% completed)

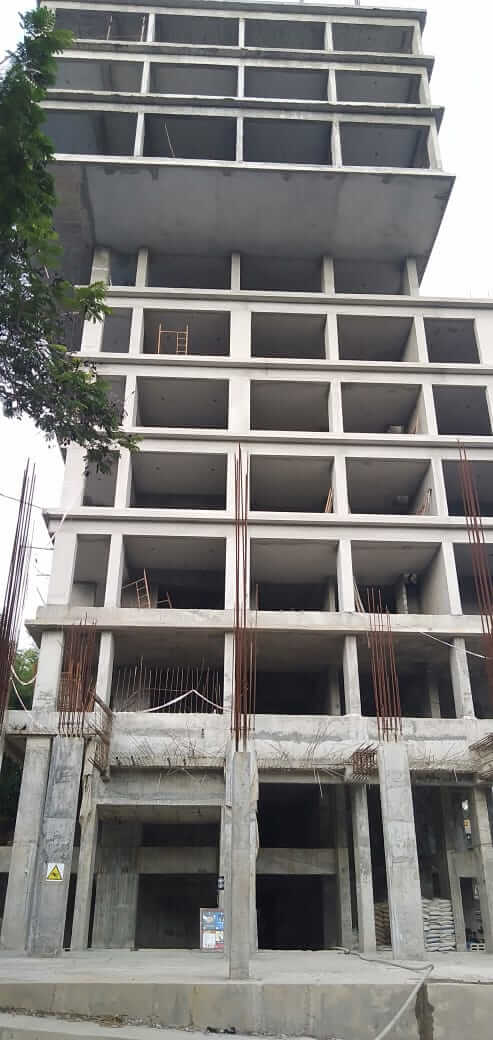

  • Column work -BF-12th floor column work 50%completed

As per the current work status from our site we are targeted to complete the following works by end of February 2019

  • Block work – 7 th floor 100% to be completed.
  • Ceiling Plastering work – 7th floor – 100% to be completed

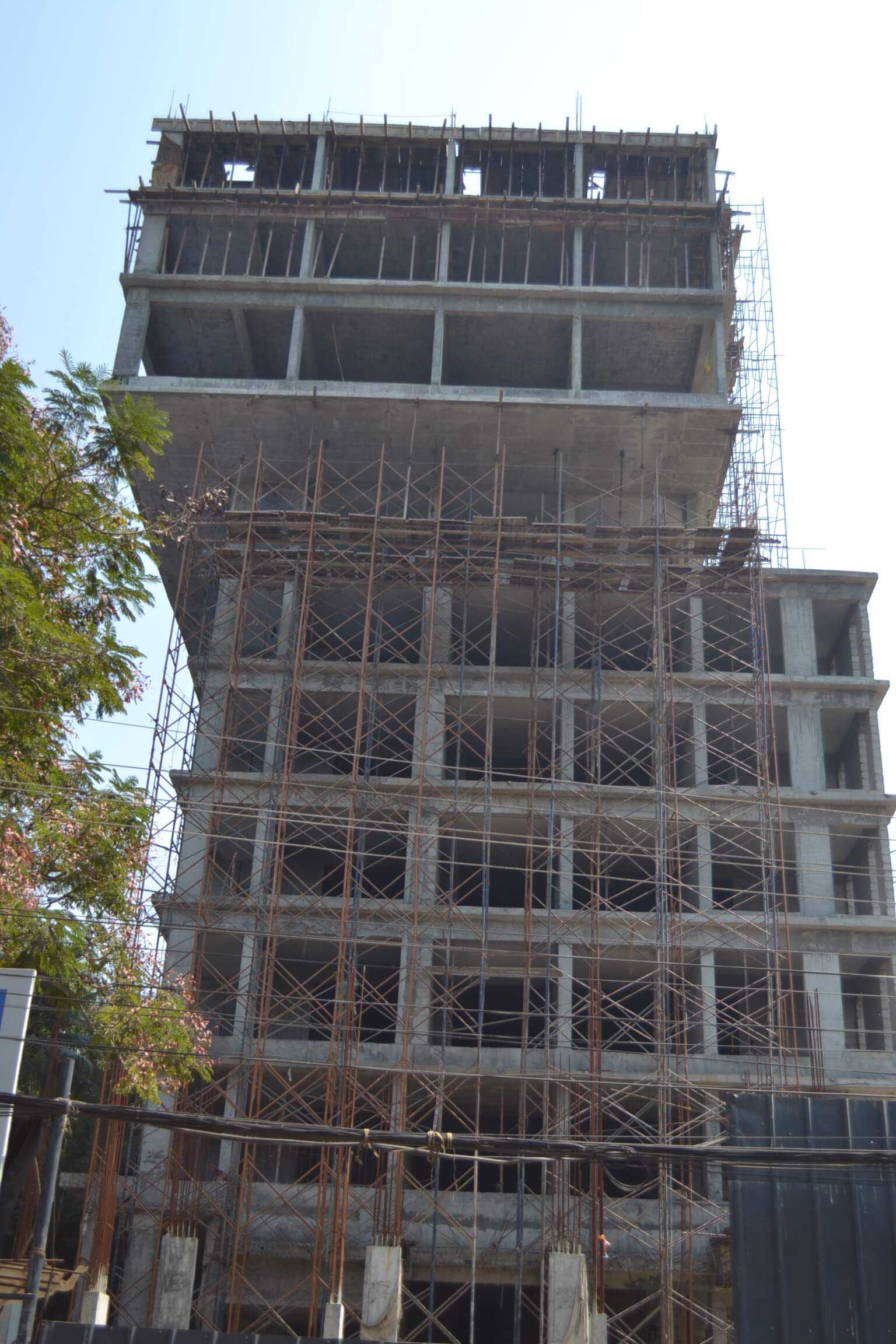

  • Roof slab work – 12th floor -70% to be completed
  • Column work -11 th floor column work 100% to be completed

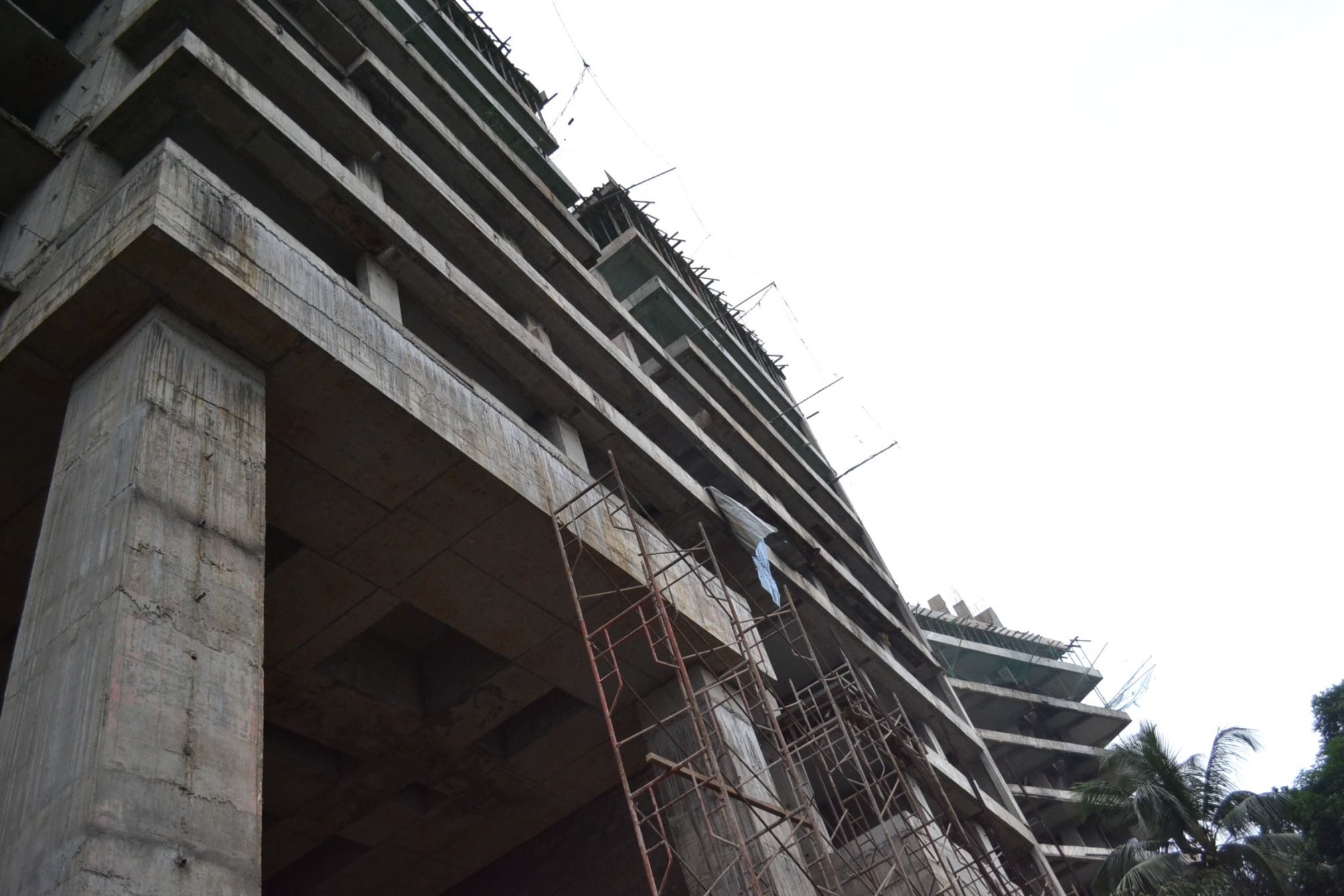

Work status as on 05-02-2019, we have completed the following

  • Piling work – 100% completed
  • Pile chipping work – 100% completed
  • Pile cap work – 100% completed
  • BF column work – 100% completed
  • Block work – 1st floor (100%completed); 2nd floor (60% completed); 3rd floor (75% completed); 4th floor (100% completed);5th floor(100% completed),6th floor(100% completed)
  • Ceiling Plastering work – 2nd floor (60% completed); 3rd floor (100% completed),4 th floor-100% completed, 5 th -100%completed,6 th -100%completed
  • Roof slab work – BF to 1st floor (100% completed); 2nd floor (90% completed); 3rd floor (completed) ; 4th to 6th floor (completed); 7th floor (100% completed); 8th floor (100% completed); 9th floor (100% completed); 10th floor (100% completed),11 floor -98%completed.
  • Column work -BF-10 th floor column work 100%completed

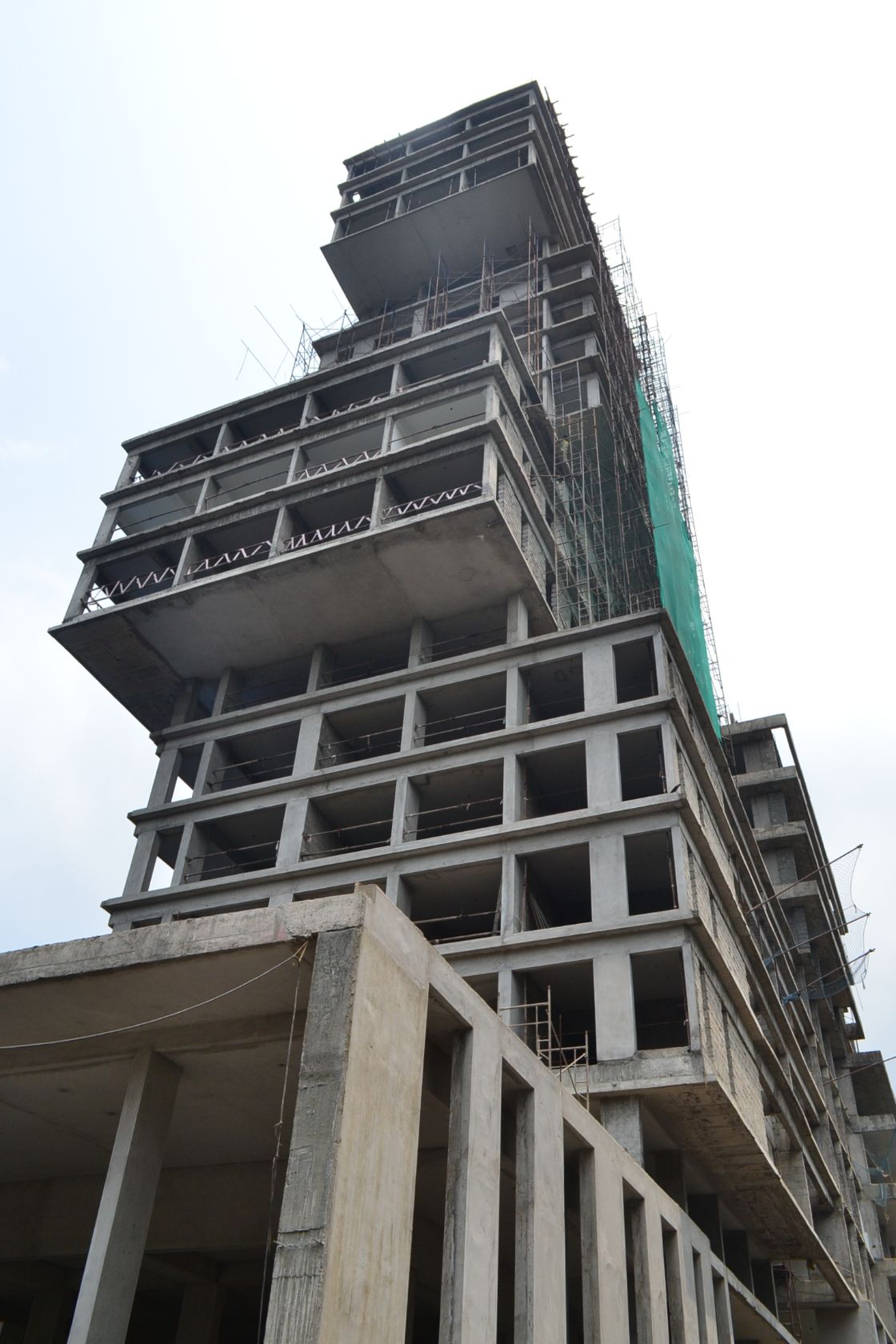

As per the current work status from our site we are targeted to complete the following works by end of January 2019

  • Block work – 6 th floor 100% to be completed.
  • Ceiling Plastering work – 5th &6th floor – 100% to be completed
  • Roof slab work – 12th floor -70% to be completed,10 th floor -100% to be completed.

Work status as on 08-01-2019, we have completed the following

  • Piling work – 100% completed
  • Pile chipping work – 100% completed
  • Pile cap work – 100% completed
  • BF column work – 100% completed
  • Block work – 1st floor (100%completed); 2nd floor (60% completed); 3rd floor (75% completed); 4th floor (100% completed);5th floor(100% completed)
  • Ceiling Plastering work – 2nd floor (60% completed); 3rd floor (100% completed),4 th floor-100% completed, 5 th -60%completed.
  • Roof slab work – BF to 1st floor (100% completed); 2nd floor (90% completed); 3rd floor (completed) ; 4th to 6th floor (completed); 7th floor (100% completed); 8th floor (100% completed); 9th floor (100% completed); 10th floor (70% completed),11 floor -70%completed.

As per the current work status from our site we are targeted to complete the following works by end of December 2019

  • Block work – 5th floor – 75% to be completed;6 th floor -50% to be completed.
  • Ceiling Plastering work – 5th floor – 50% to be completed
  • Roof slab work – 9th floor (100% to be completed); 11th floor (70% to be completed)

Work status as on 06-12-2018, we have completed the following

  • Piling work – 100% completed
  • Pile chipping work – 100% completed
  • Pile cap work – 100% completed
  • BF column work – 100% completed
  • Block work – 1st floor (100%completed); 2nd floor (60% completed); 3rd floor (75% completed); 4th floor (75% completed);5th floor(50% completed)
  • Ceiling Plastering work – 2nd floor (60% completed); 3rd floor (100% completed),4 th floor-100% completed

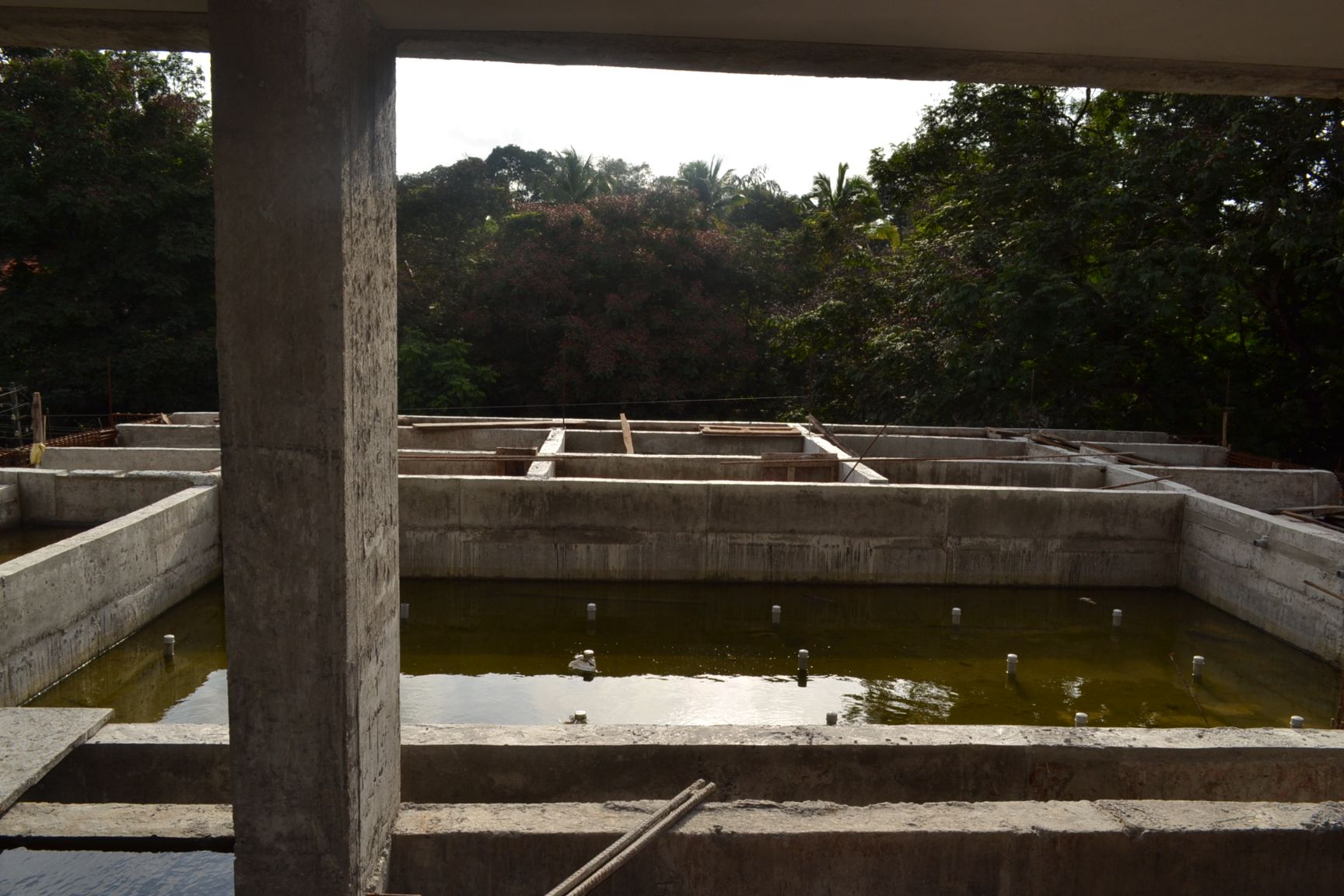

  • Roof slab work – BF to 1st floor (100% completed); 2nd floor (90% completed); 3rd floor (completed) ; 4th to 6th floor (completed); 7th floor (100% completed); 8th floor (70% completed); 9th floor (70% completed); 10th floor (70% completed),11 floor shuttering and steel work in progress

As per the current work status from our site we are targeted to complete the following works by end of November 2018

  • Block work – 4th floor – 100% to be completed
  • Ceiling Plastering work – 2nd floor – 50% to be completed
  • Roof slab work – 8th floor (100% to be completed); 10th floor (70% to be completed)

Work status as on 16-11-2018, we have completed the following.

  • Piling work – 100% completed
  • Pile chipping work – 100% completed
  • Pile cap work – 100% completed
  • BF column work – 100% completed
  • Block work – 1st floor (60%completed); 2nd floor (60% completed); 3rd floor (100% completed); 4th floor (50% completed)
  • Ceiling Plastering work – 2nd floor (25% completed); 3rd floor (50% completed)
  • Roof slab work – BF to 1st floor (100% completed); 2nd floor (90% completed); 3rd floor (completed) ; 4th to 6th floor (completed); 7th floor (100% completed); 8th floor (70% completed); 9th floor (70% completed); 10th floor (50% completed)

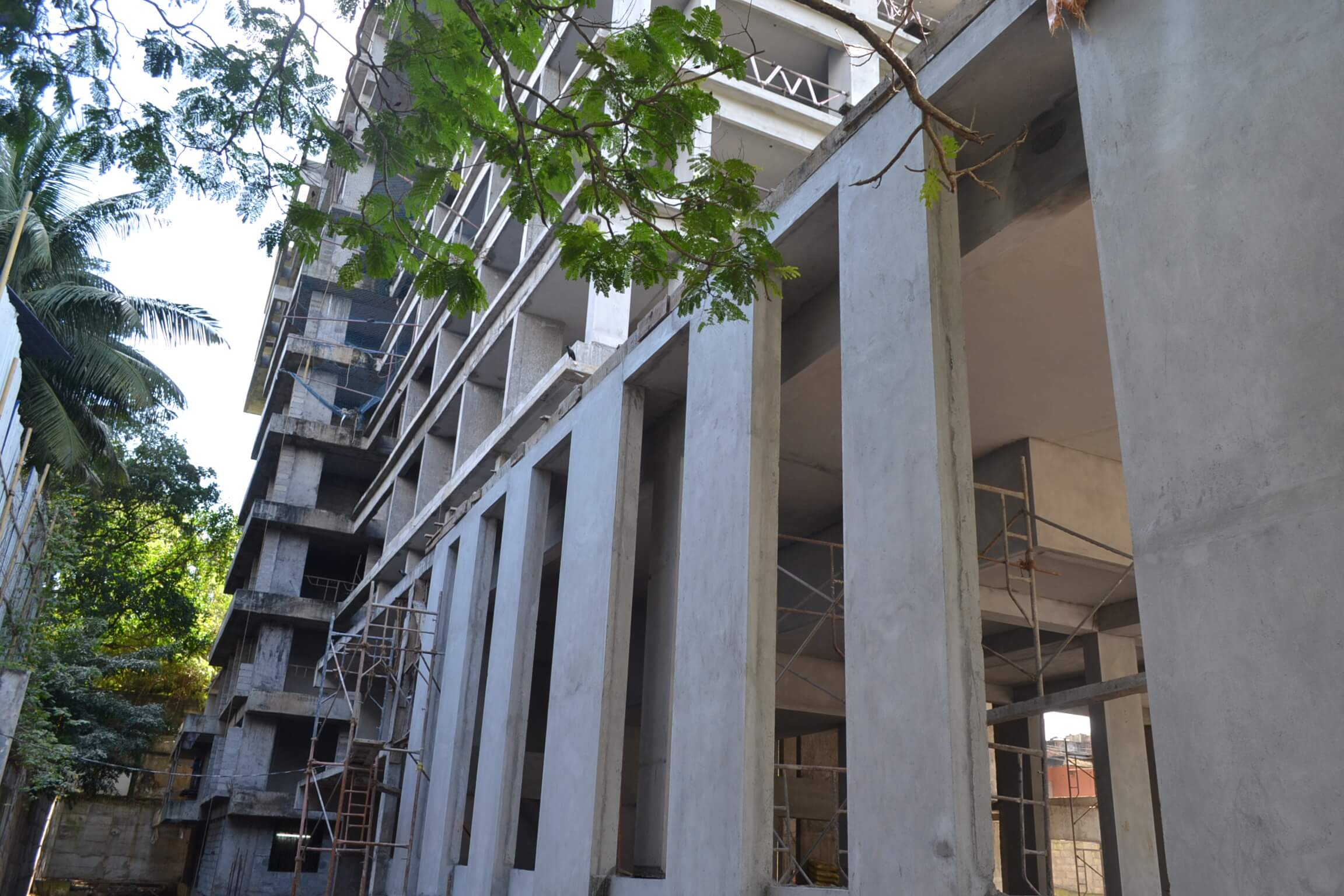

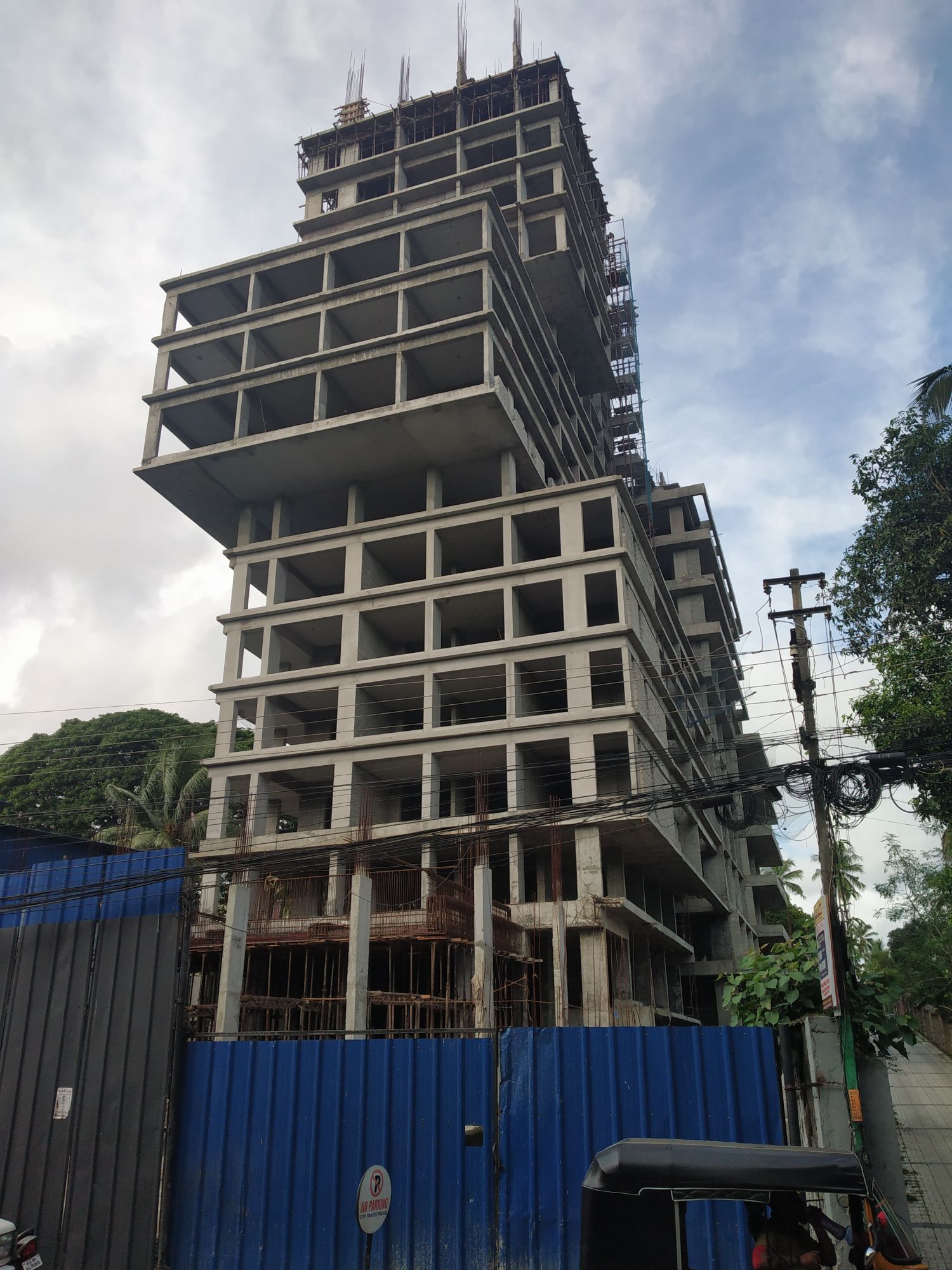

As per the current work status from our site we are targeted to complete the following works by end of July 2018

  • Roof slab work – 3rd floor (100% to be completed); 7th floor (70% to
    be completed); 8th floor (60% to be completed)

Work status as on 16-07-2018, we have completed the following.

  • Piling work – 100% completed
  • Pile chipping work – 100% completed
  • Pile cap work – 100% completed
  • BF column work – 100% completed
  • Roof slab work – BF to 1st floor (100% completed); 2nd floor (90%
    completed); 3rd to 6th floor (70%completed); 7th floor (50% completed)

As per the current work status from our site we are targeted to complete the following works by end of May 2018

  • Pile cap work – 100% to be completed
  • BF column work – 100% to be completed
  • Roof slab work – 6th floor – 10% to be completed

Work status as on 05-05-2018, we have completed the following.

  • Piling work – 100% completed
  • Pile chipping work – 100% completed
  • Pile cap work – 33 nos completed (out of 35)
  • BF column work – 64 nos completed (out of 66)

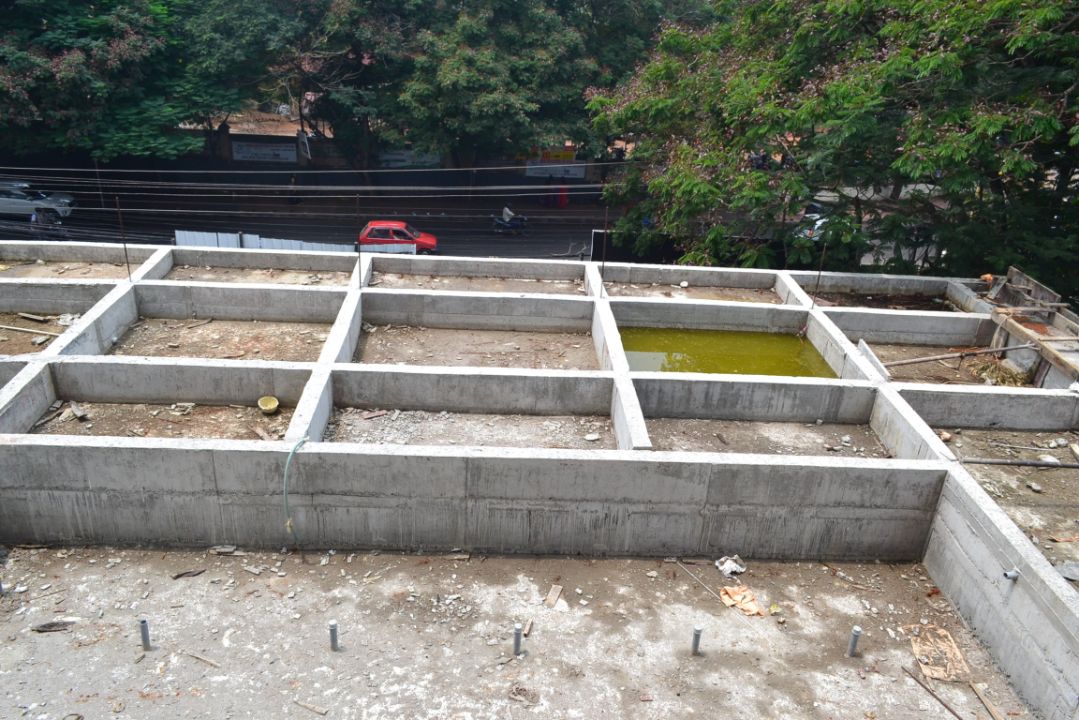

  • Roof slab work – BF (100% completed) ;GF& 1st floor to 4th floor(70% completed); 5th floor(70% completed); 6th floor (60% completed)

As per the current work status from our site we are targeted to complete the following works by end of May 2018

  • Pile cap work – 100% to be completed
  • BF column work – 100% to be completed
  • Roof slab work – 6th floor – 10% to be completed

Work status as on 05-05-2018, we have completed the following.

  • Piling work – 100% completed
  • Pile chipping work – 100% completed
  • Pile cap work – 33 nos completed (out of 35)
  • BF column work – 64 nos completed (out of 66)
  • Roof slab work – BF (100% completed) ;GF& 1st floor to 4th floor(70% completed); 5th floor(70% completed); 6th floor (60% completed)

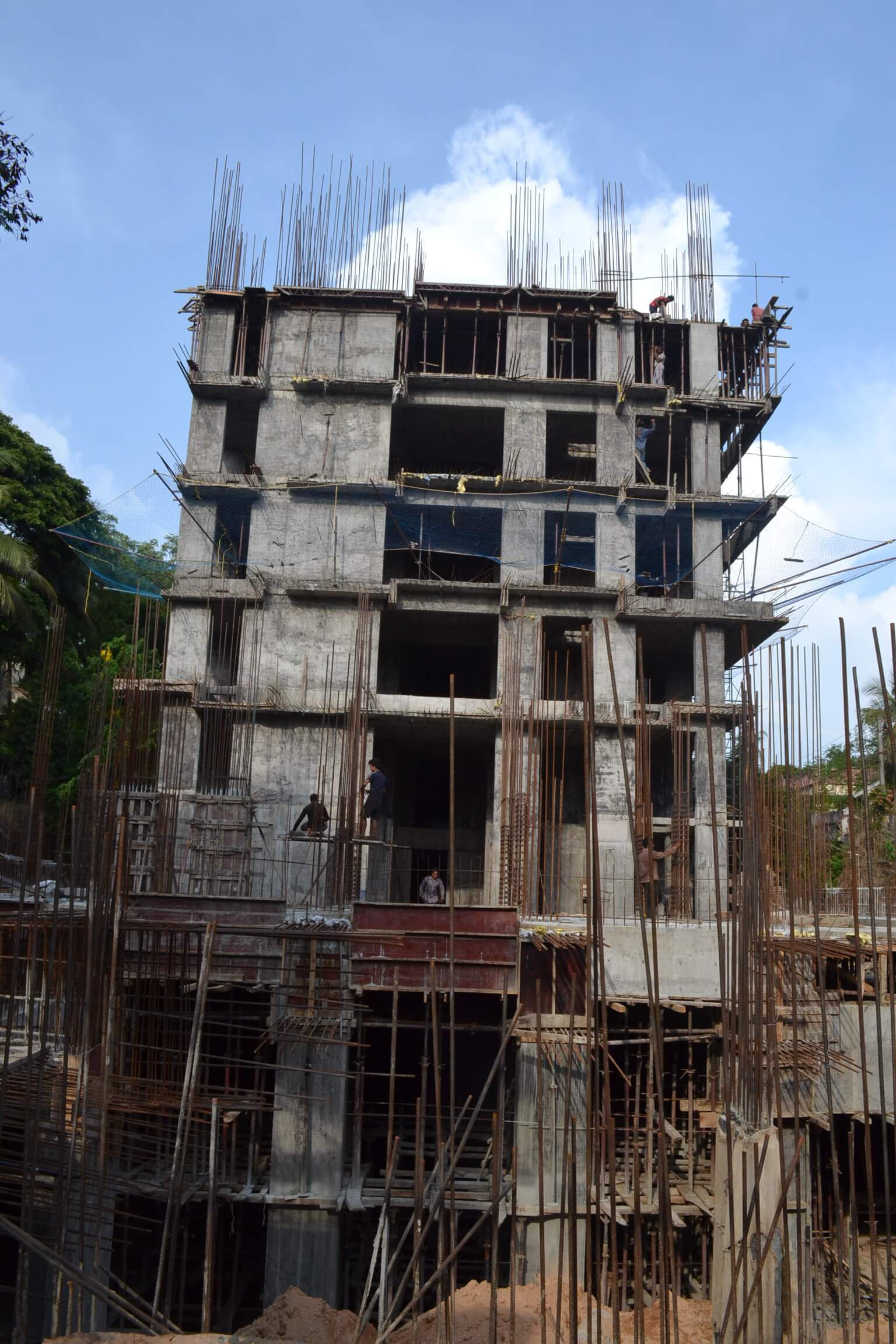

As per the current work status from our site we are targeted to complete the following works by end of April 2018

  • Pile chipping work – 211 nos to be completed (out of 211)
  • Pile cap work – 35 nos to be completed (out of 35)
  • BF column work – 66 nos to be completed (out of 66)

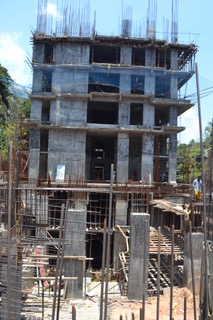

  • Roof slab work – 5th floor roof slab – 70% to be completed;

Work status as on 16-04-2018, we have completed the following.

  • Piling work – 100% completed
  • Pile chipping work – 207nos completed (out of 211)
  • Pile cap work – 33 nos completed (out of 35)
  • BF column work – 62 nos completed (out of 66)
  • Roof slab work – BF (100% completed) ;GF& 1st floor to 4th floor(70% completed);5th floor(60% completed)
