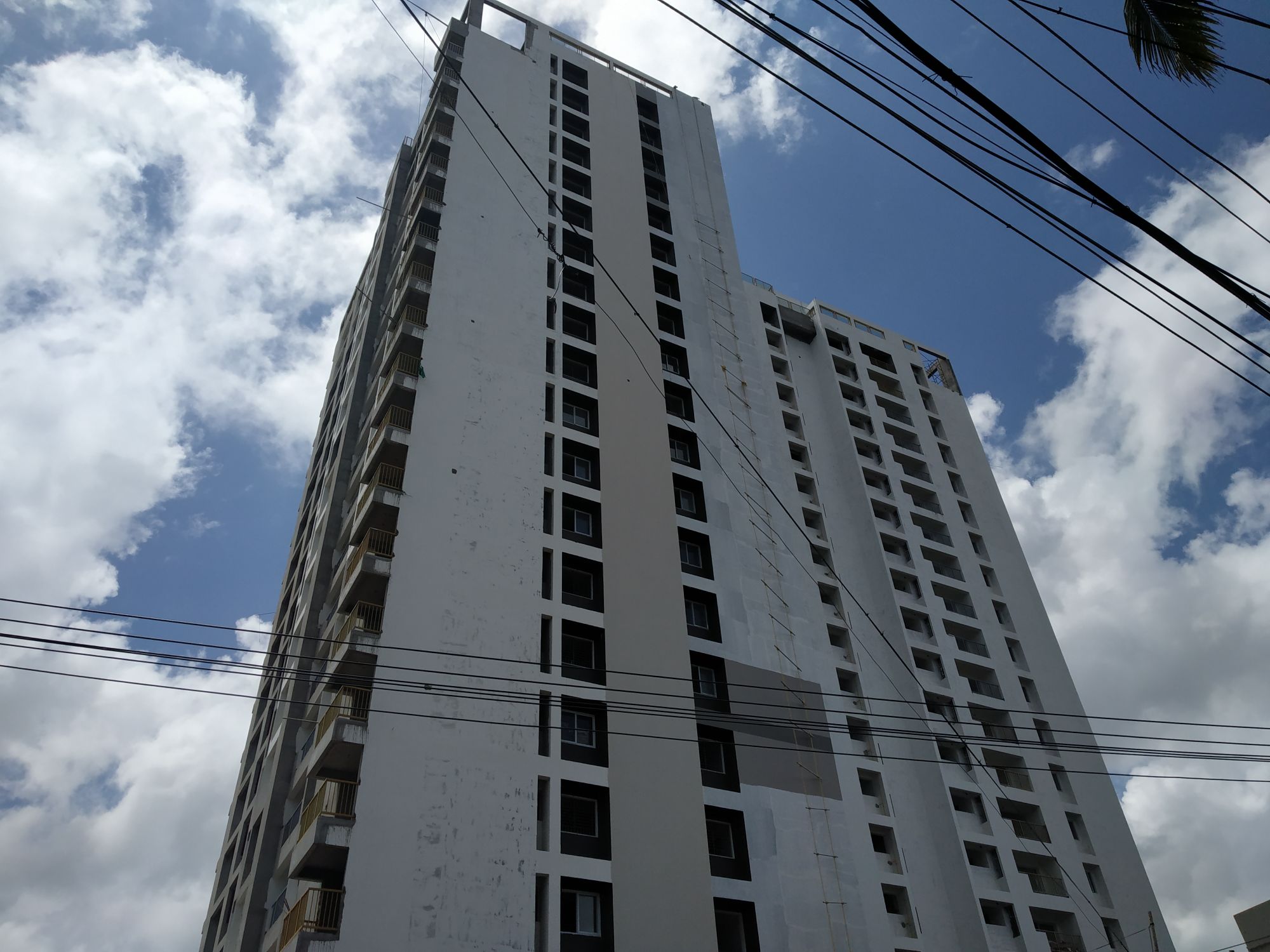

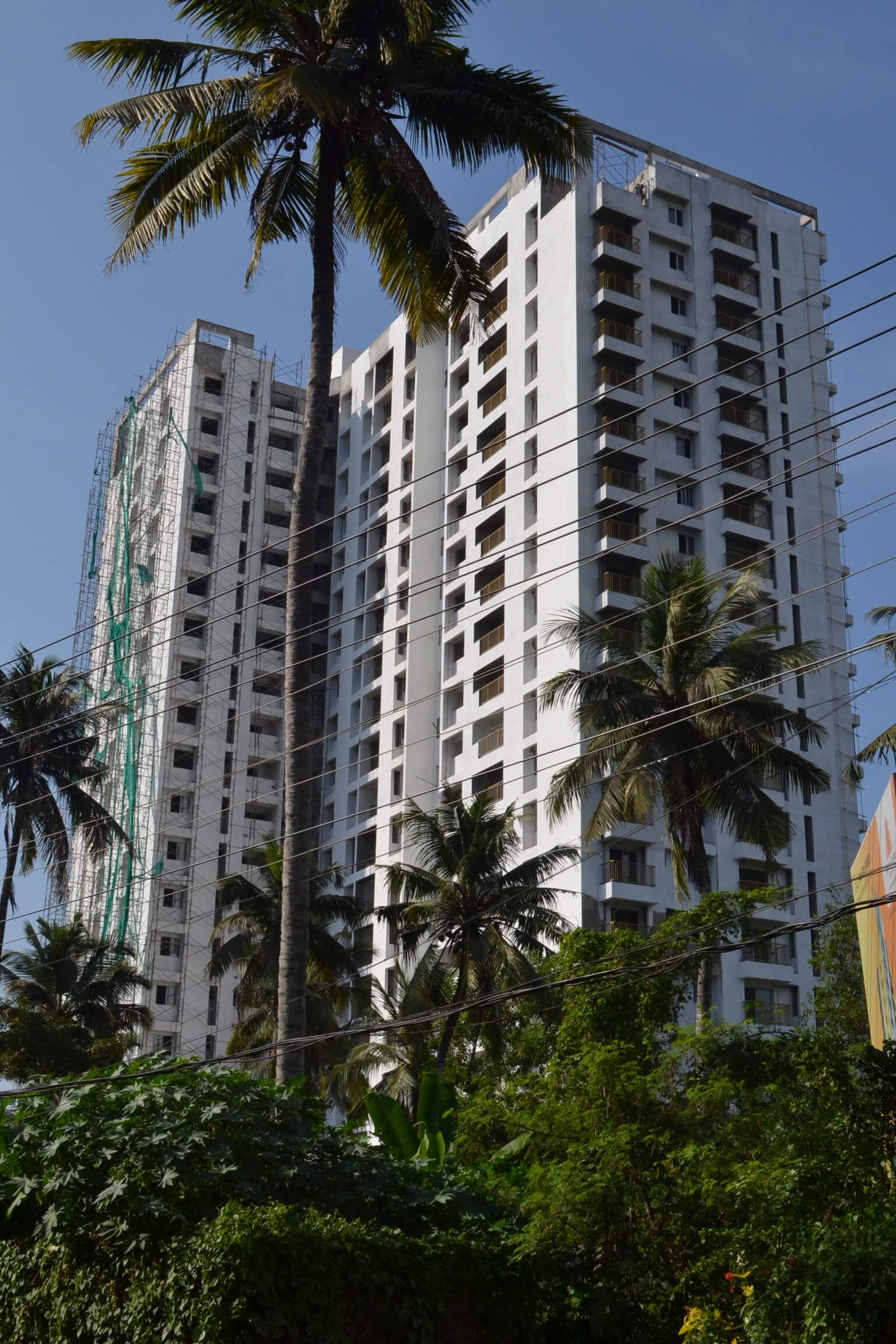

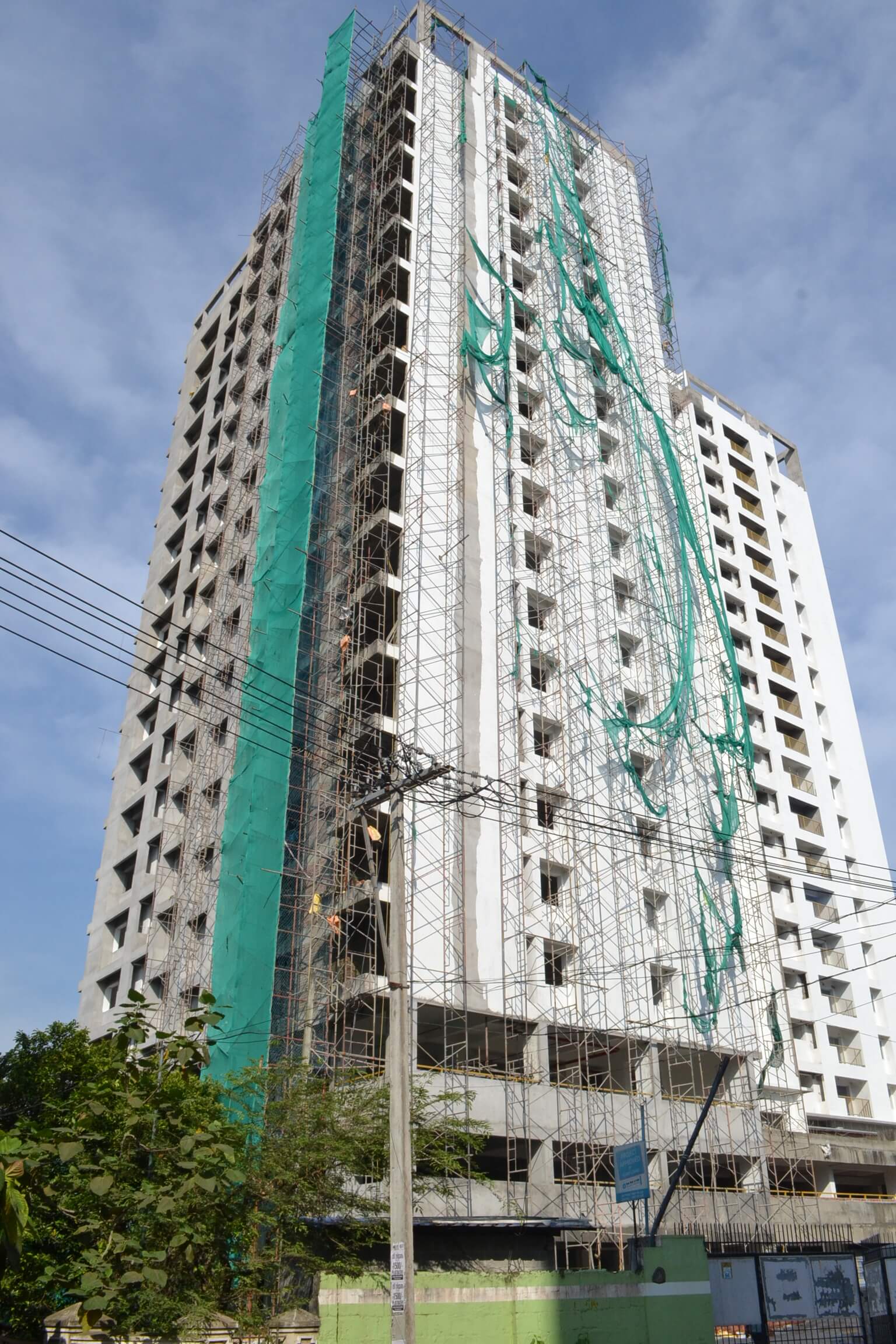

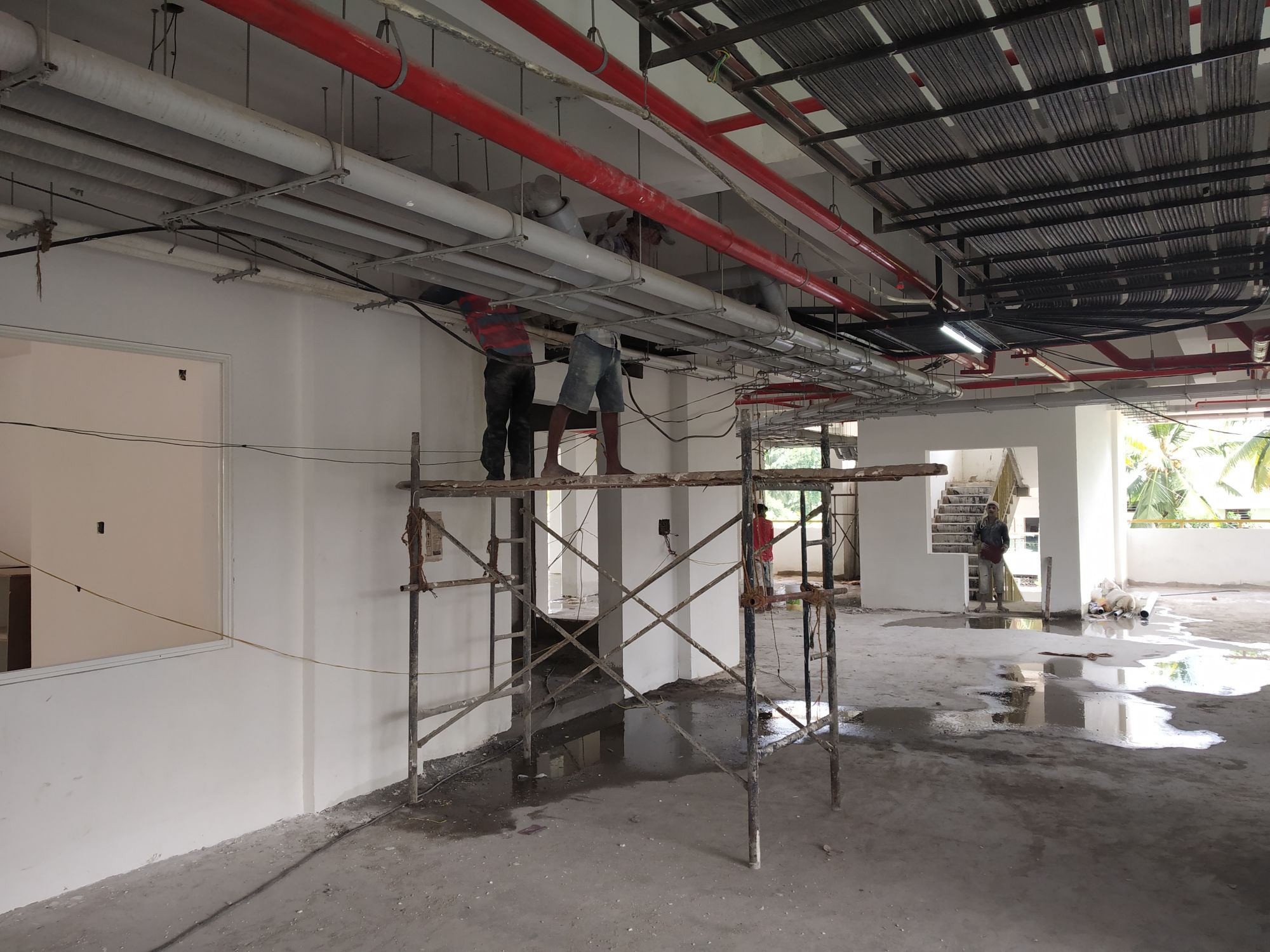

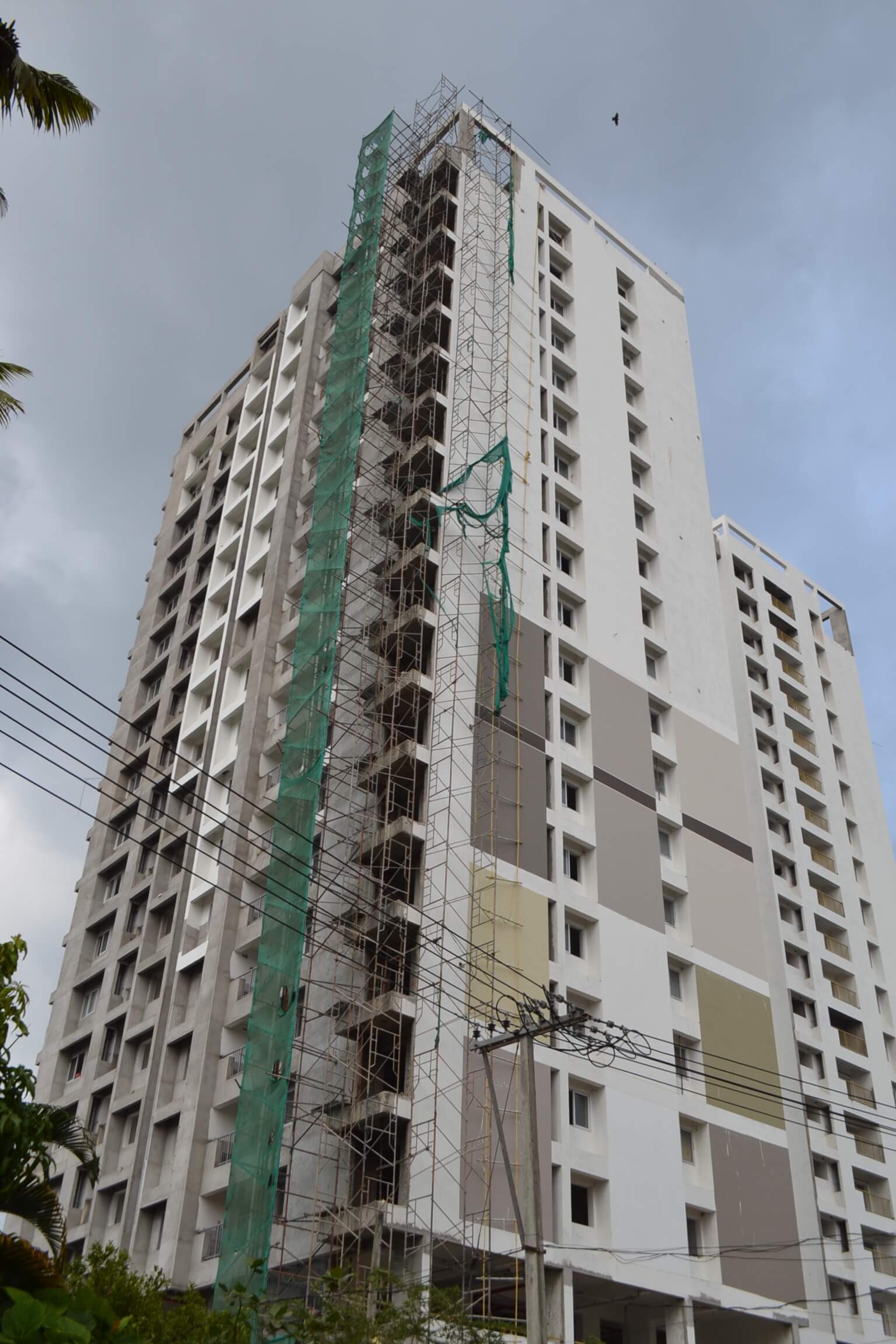

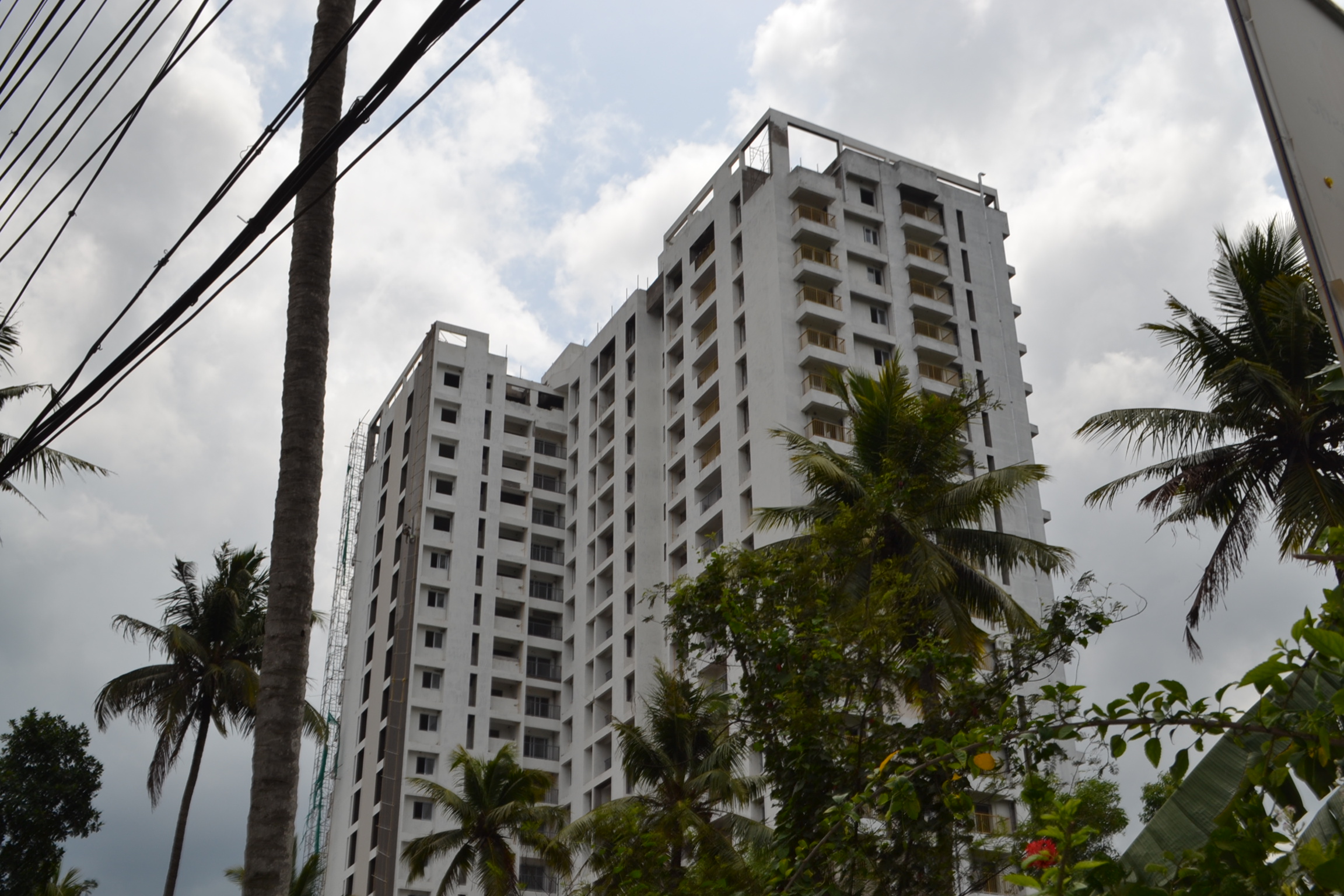

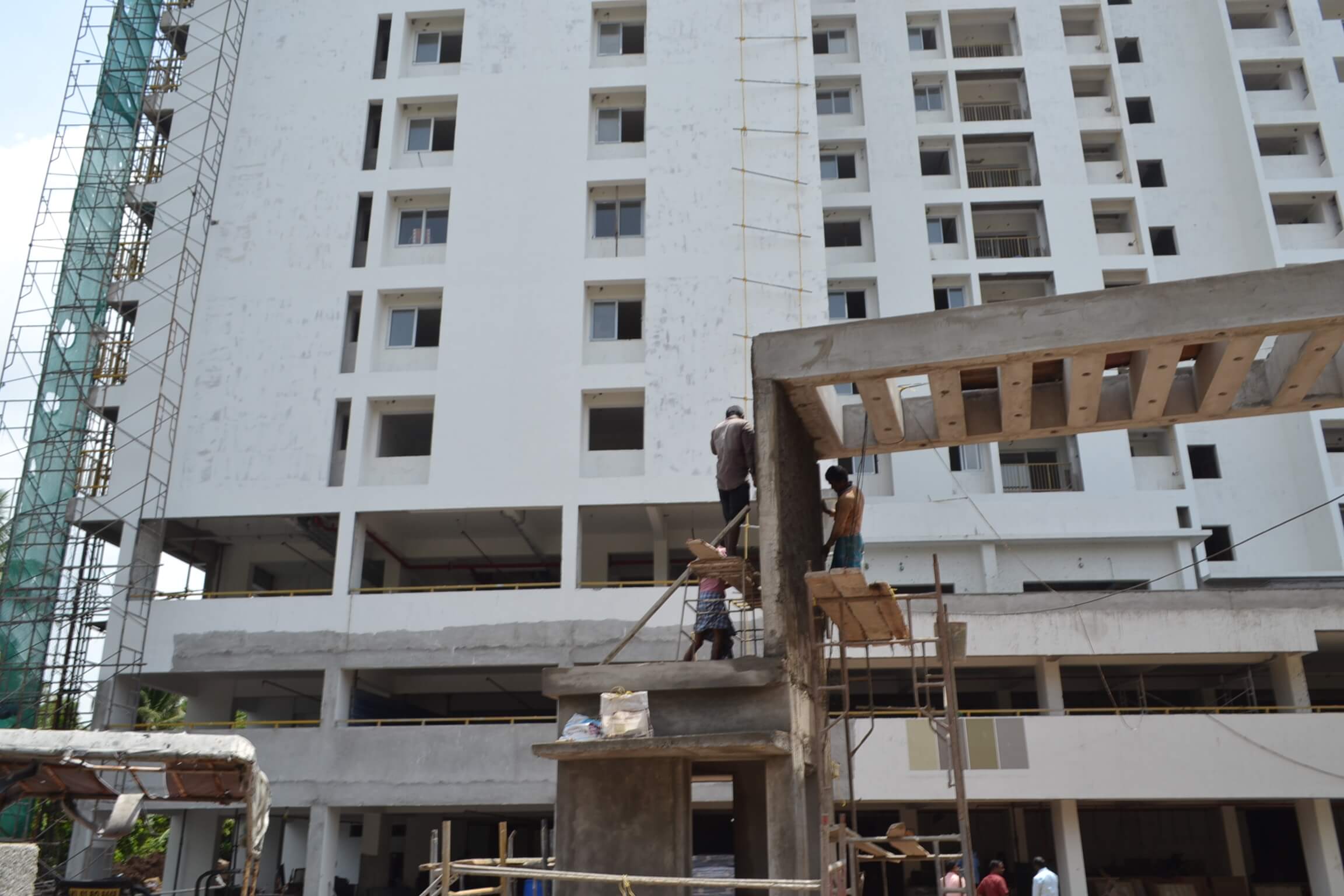

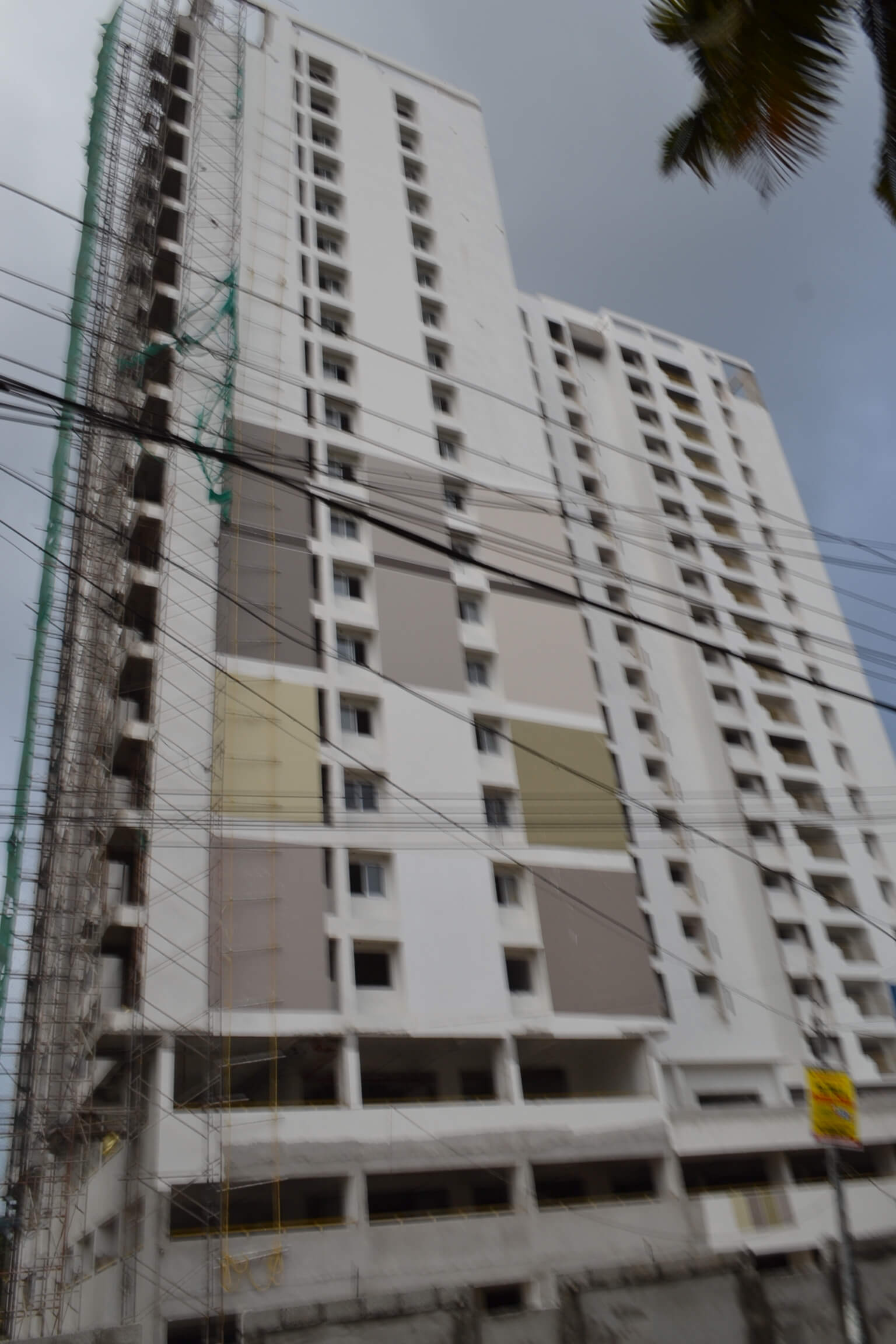

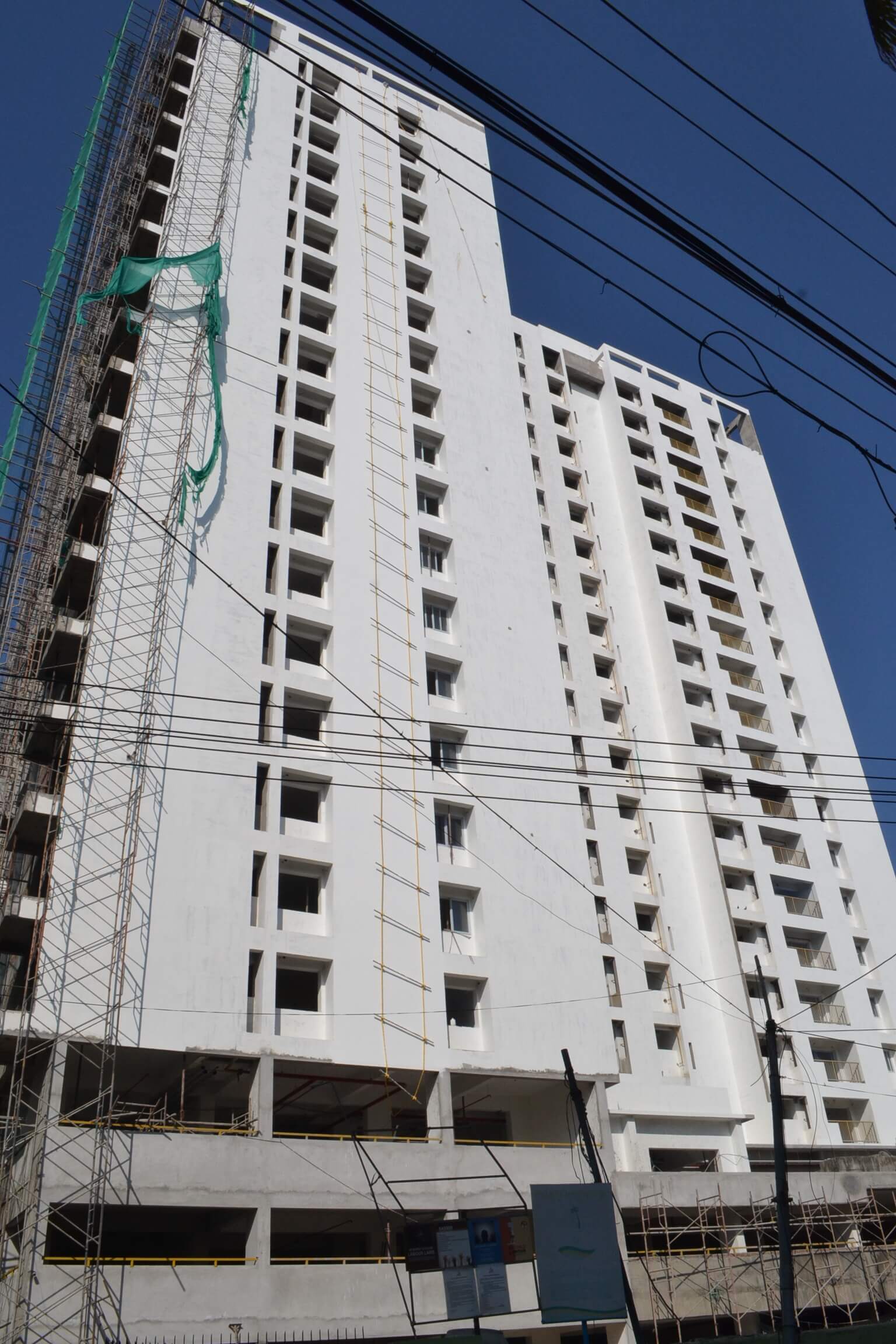

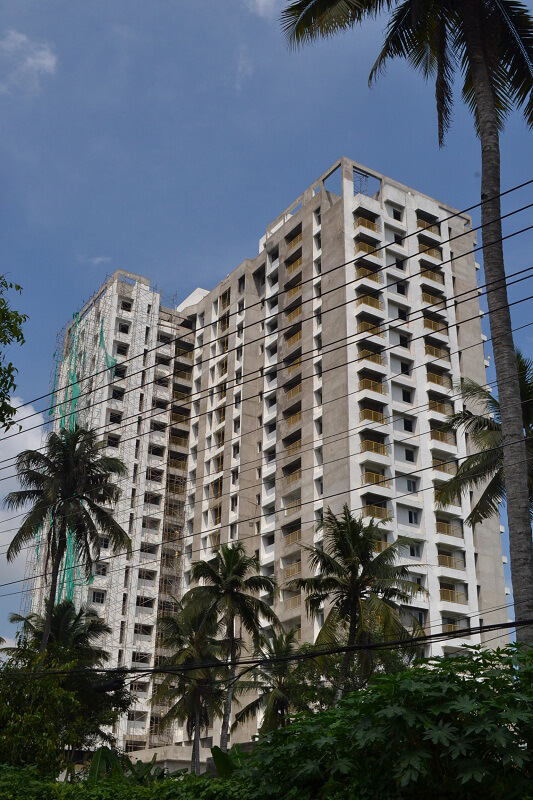

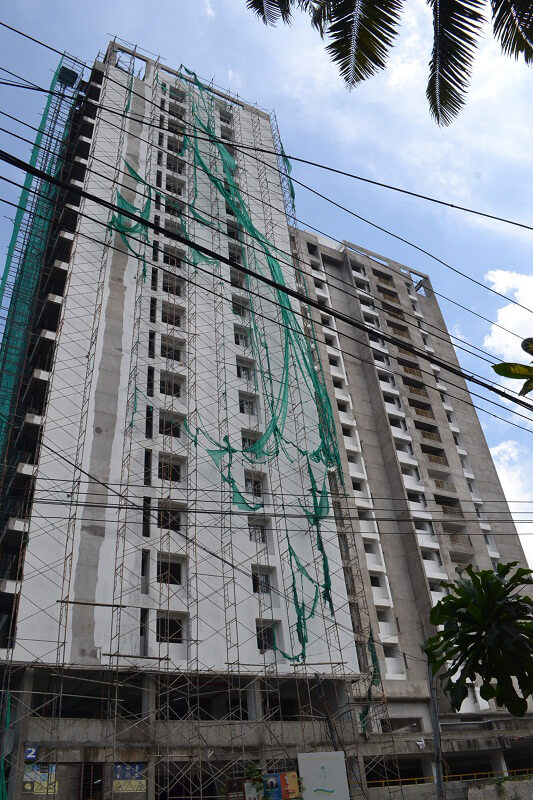

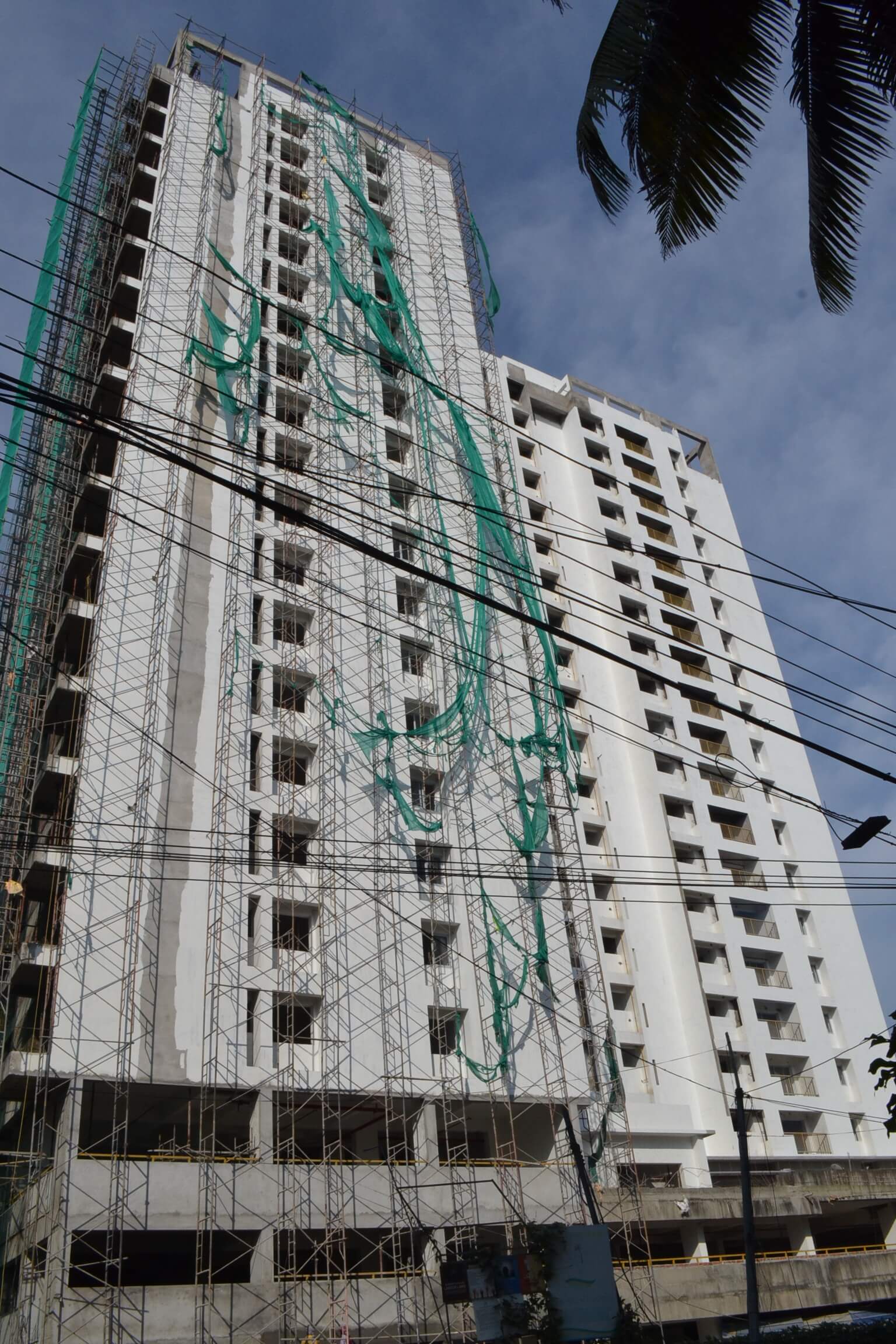

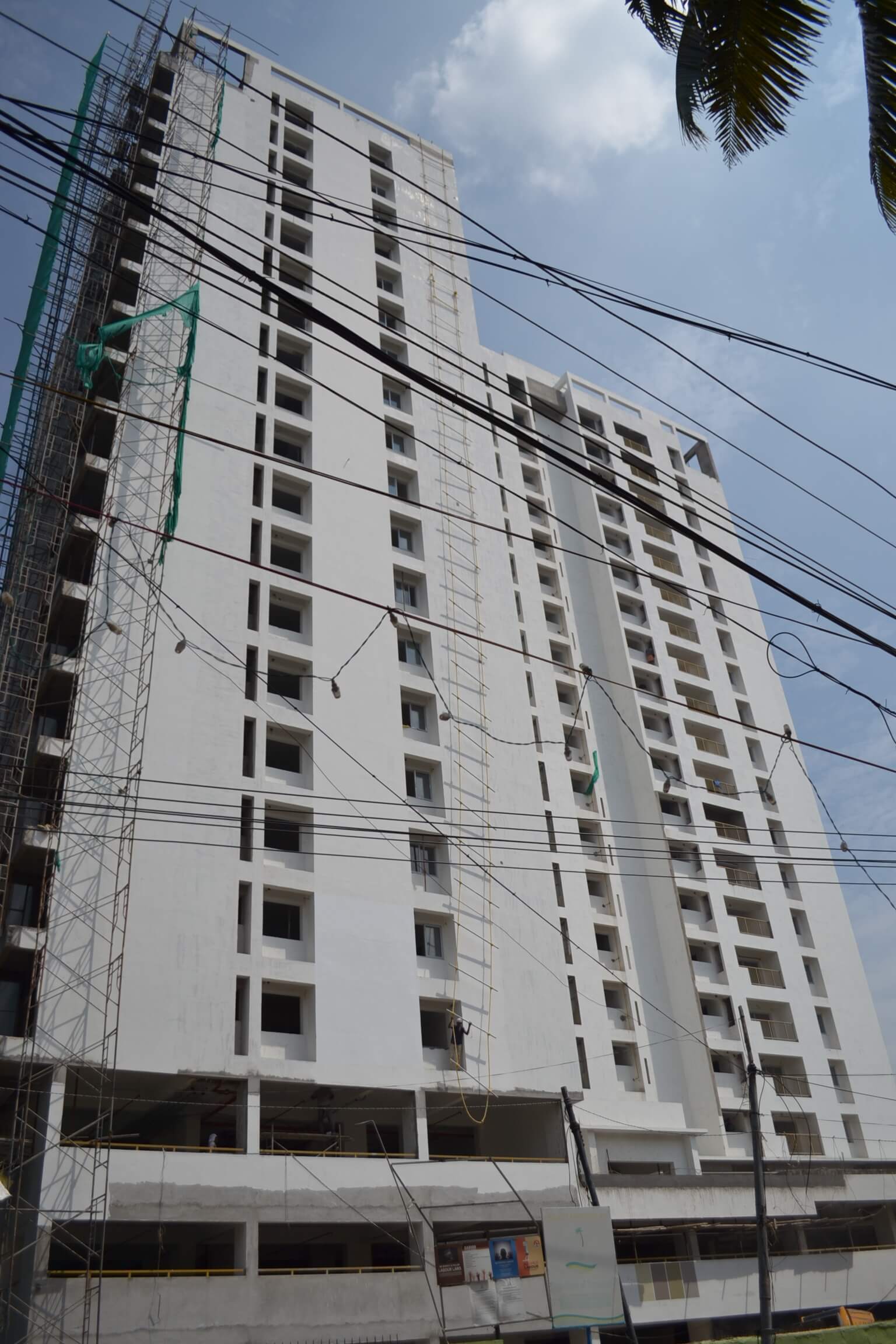

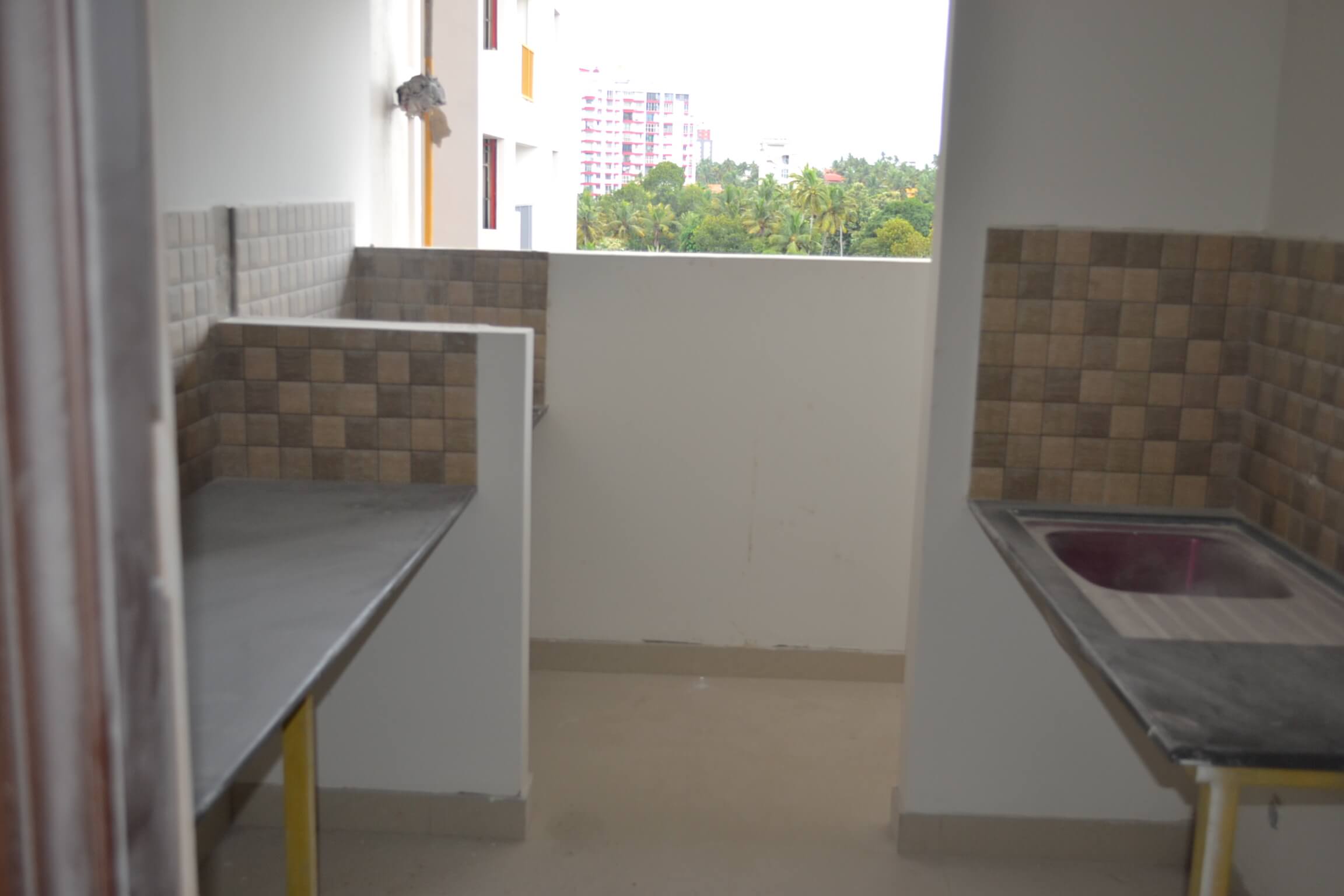

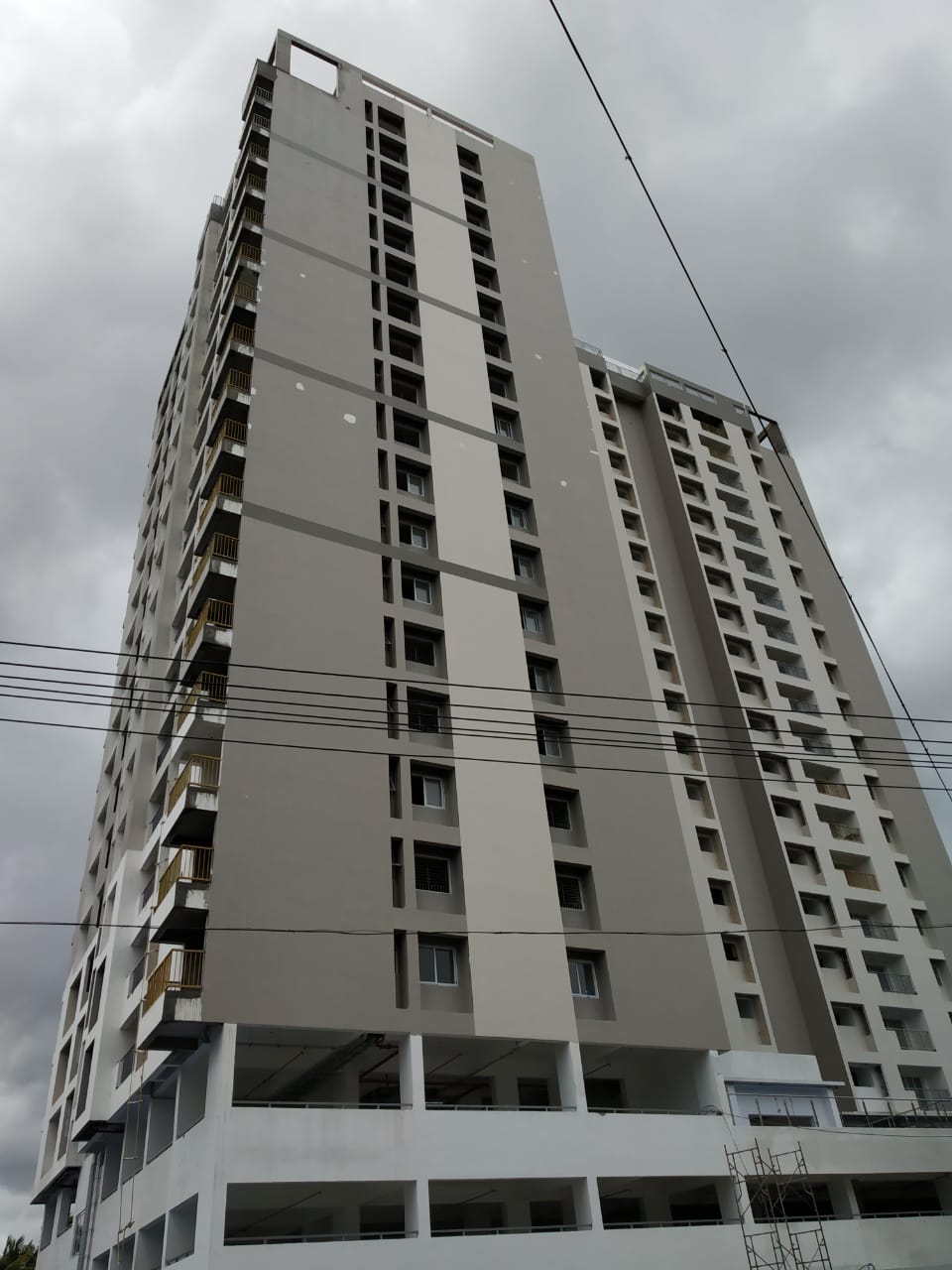

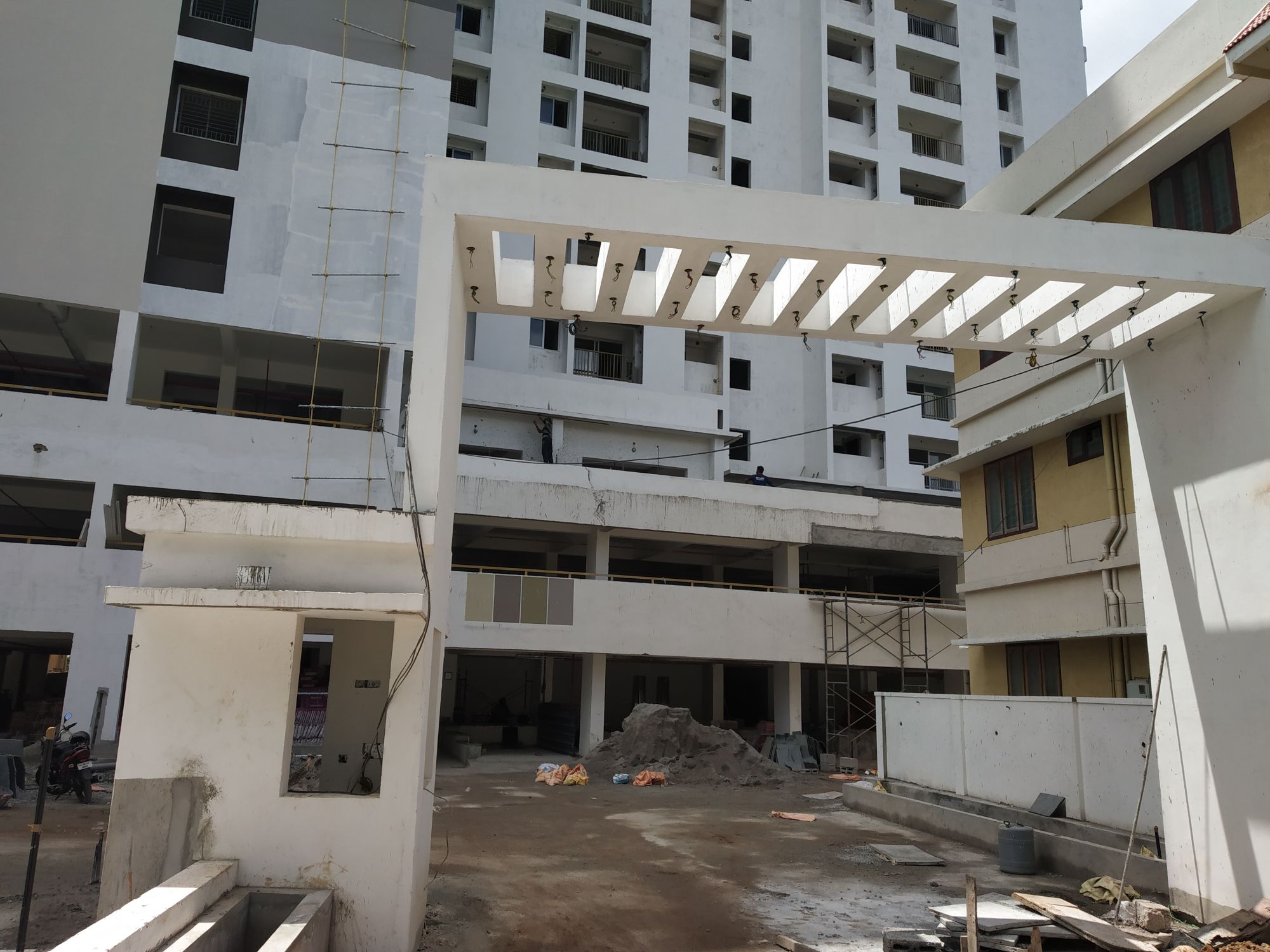

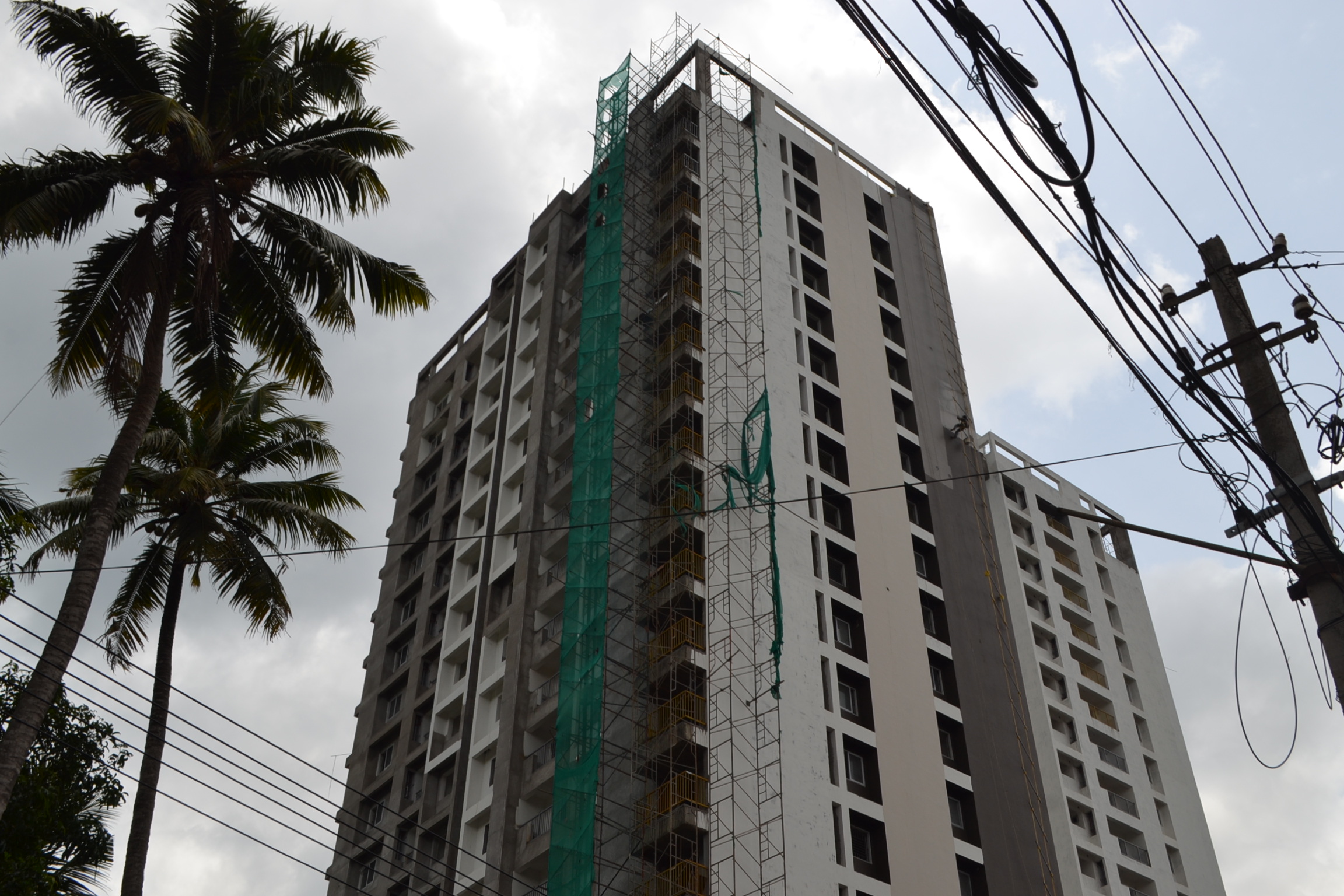

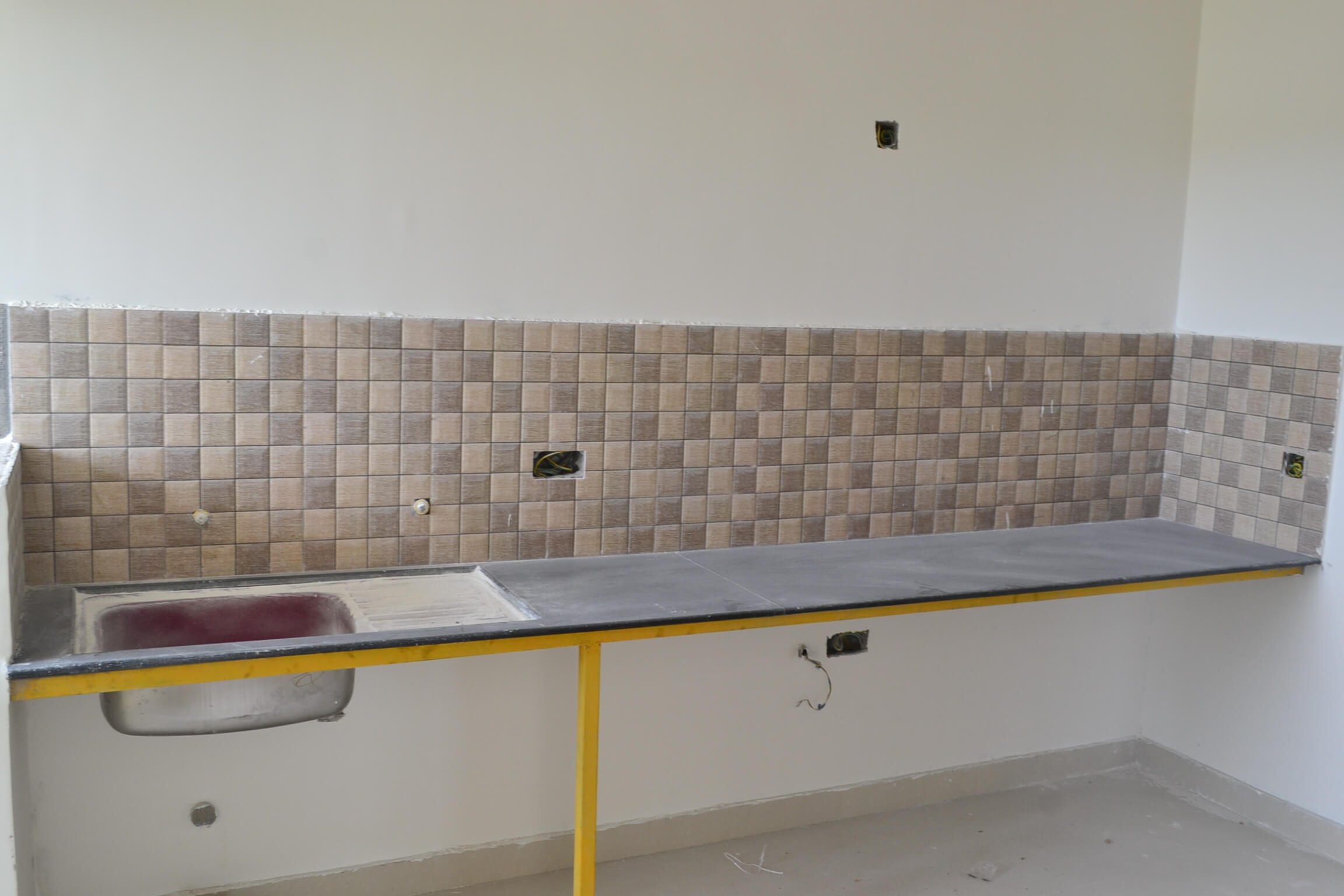

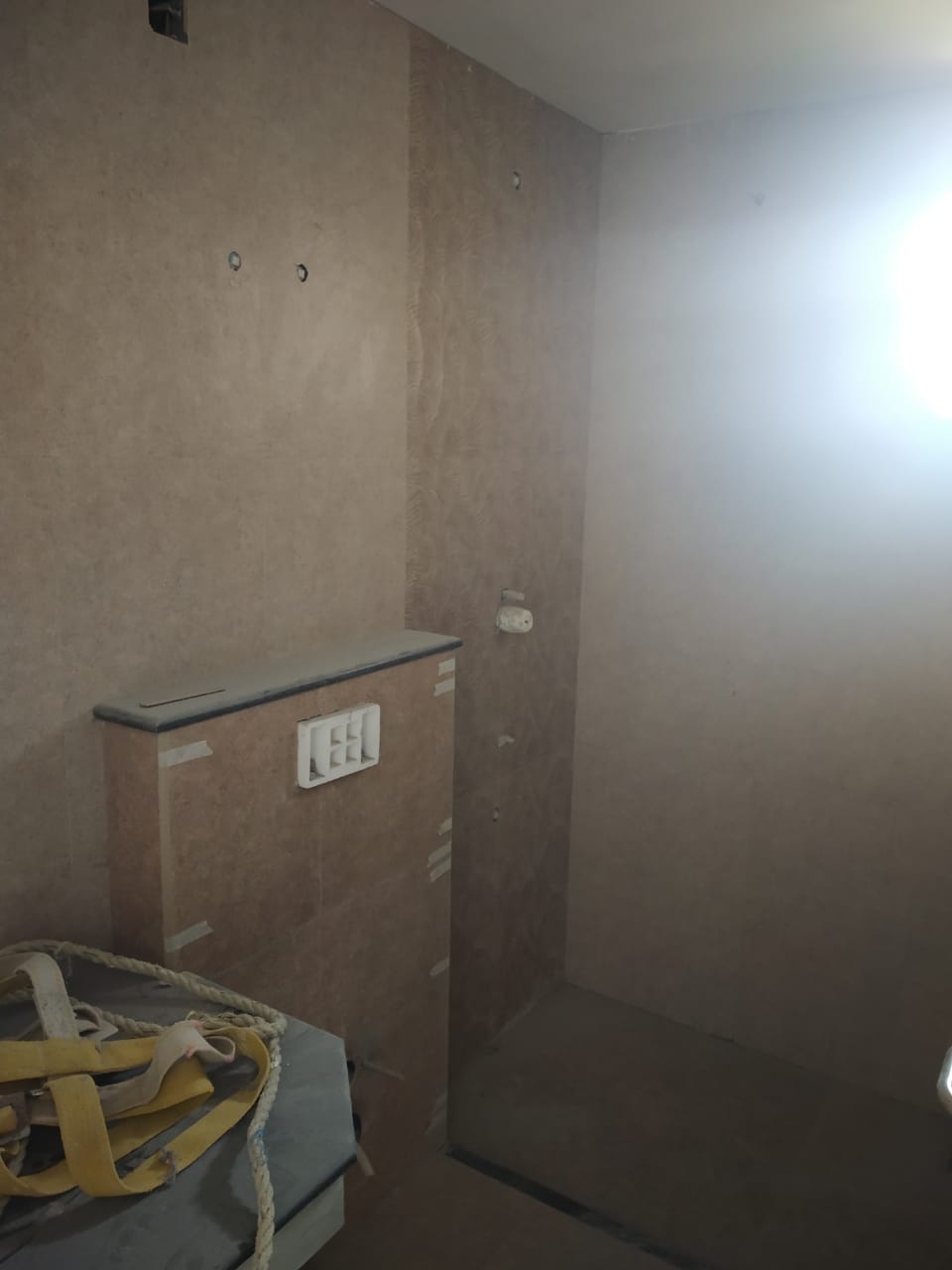

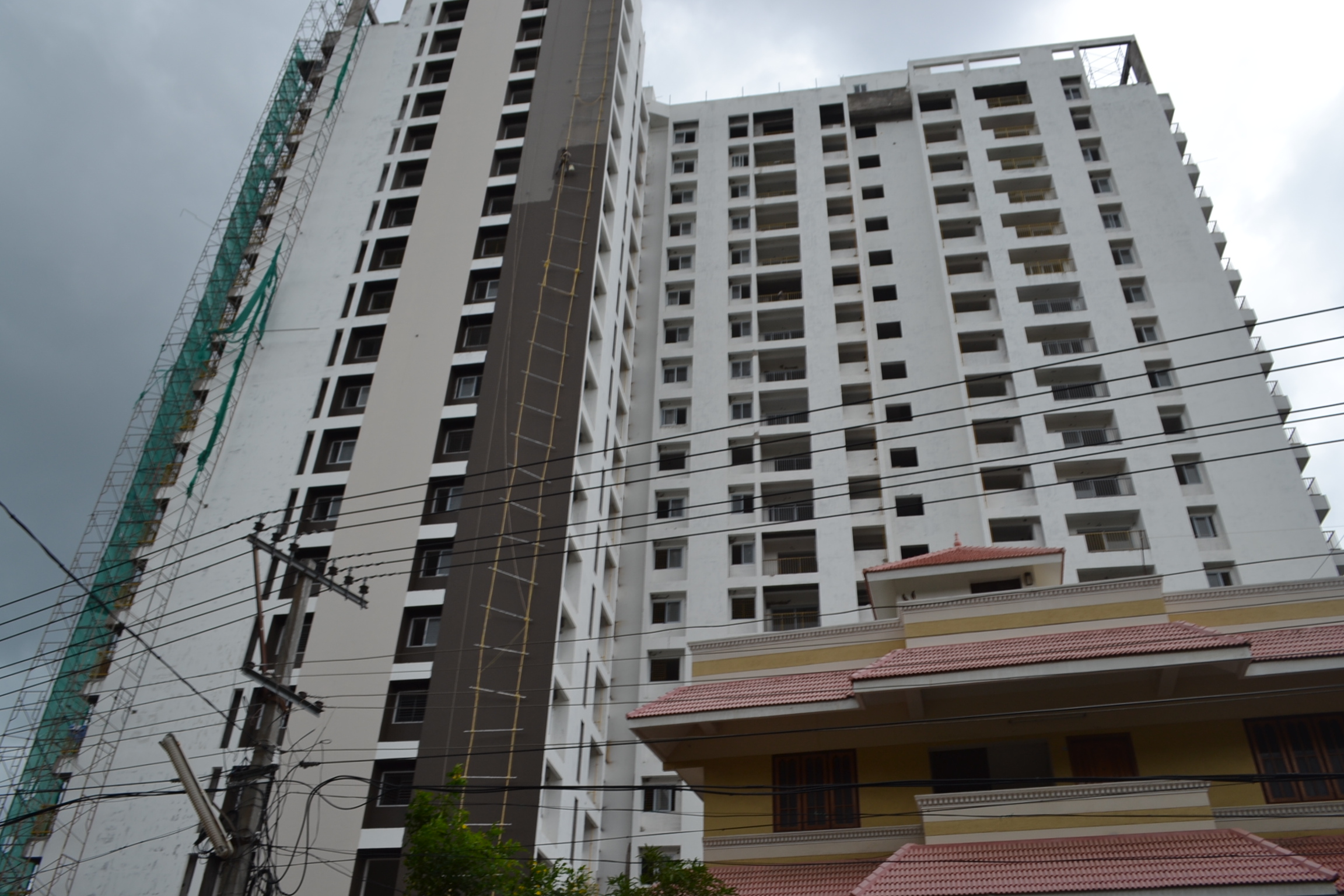

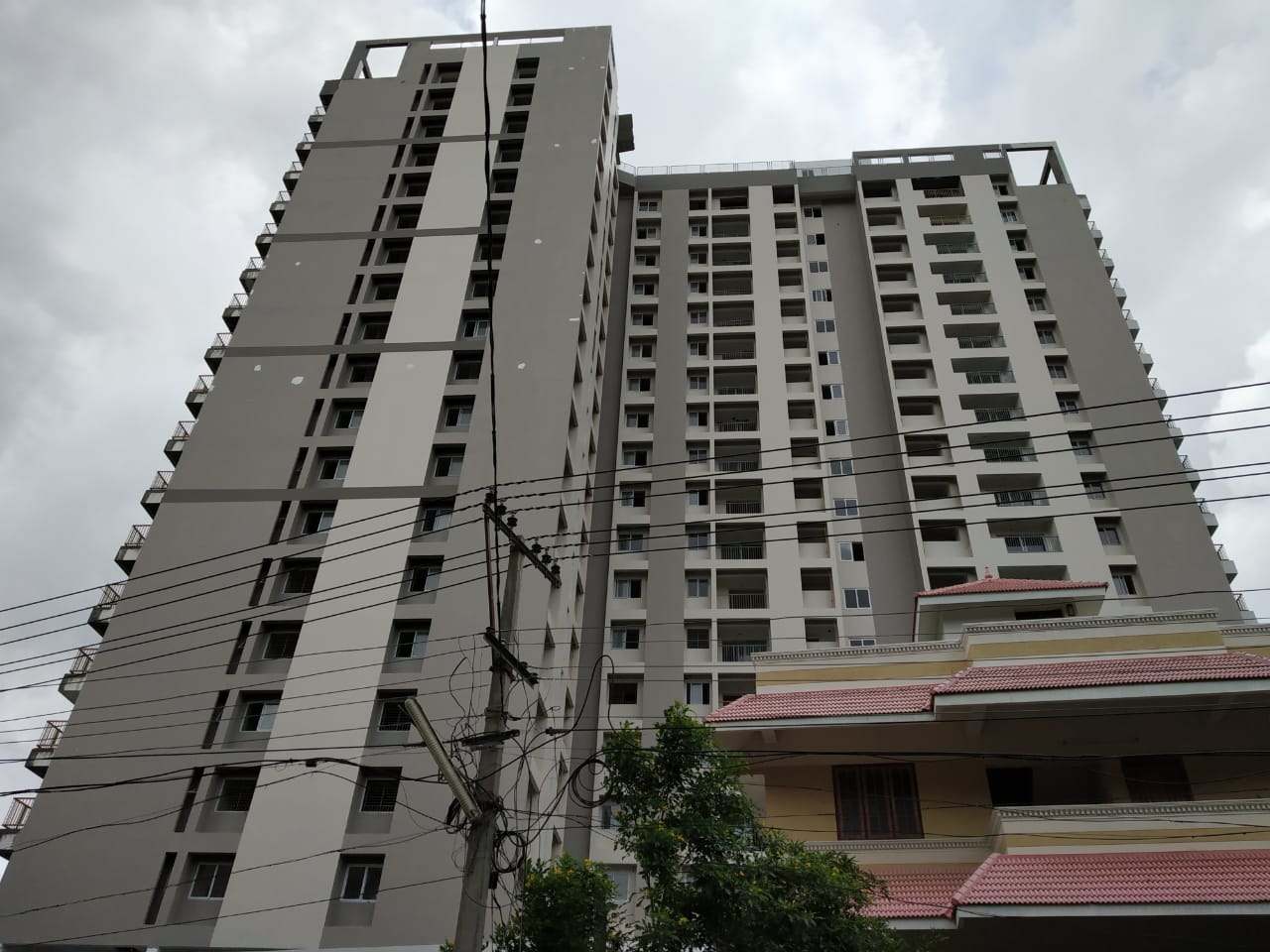

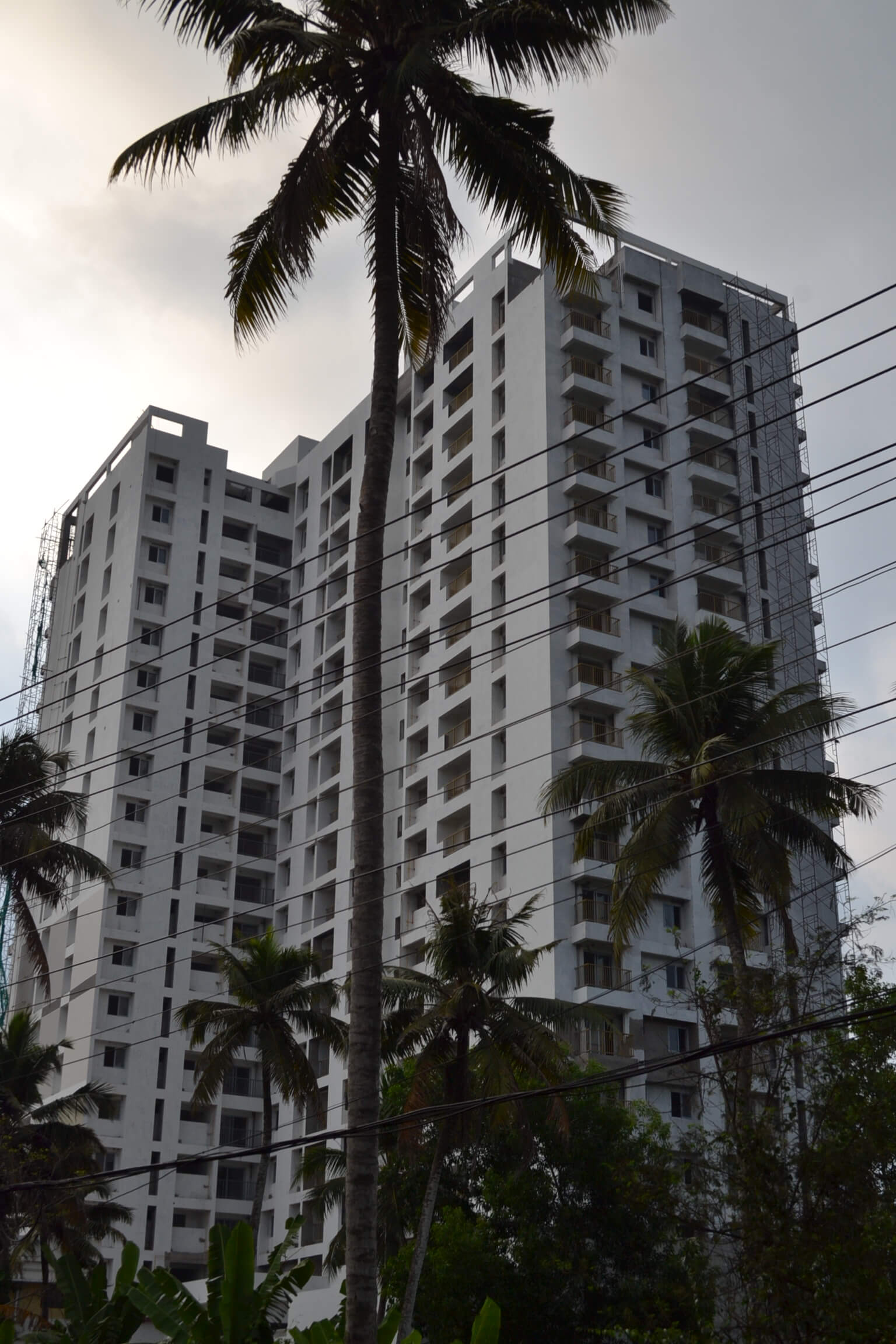

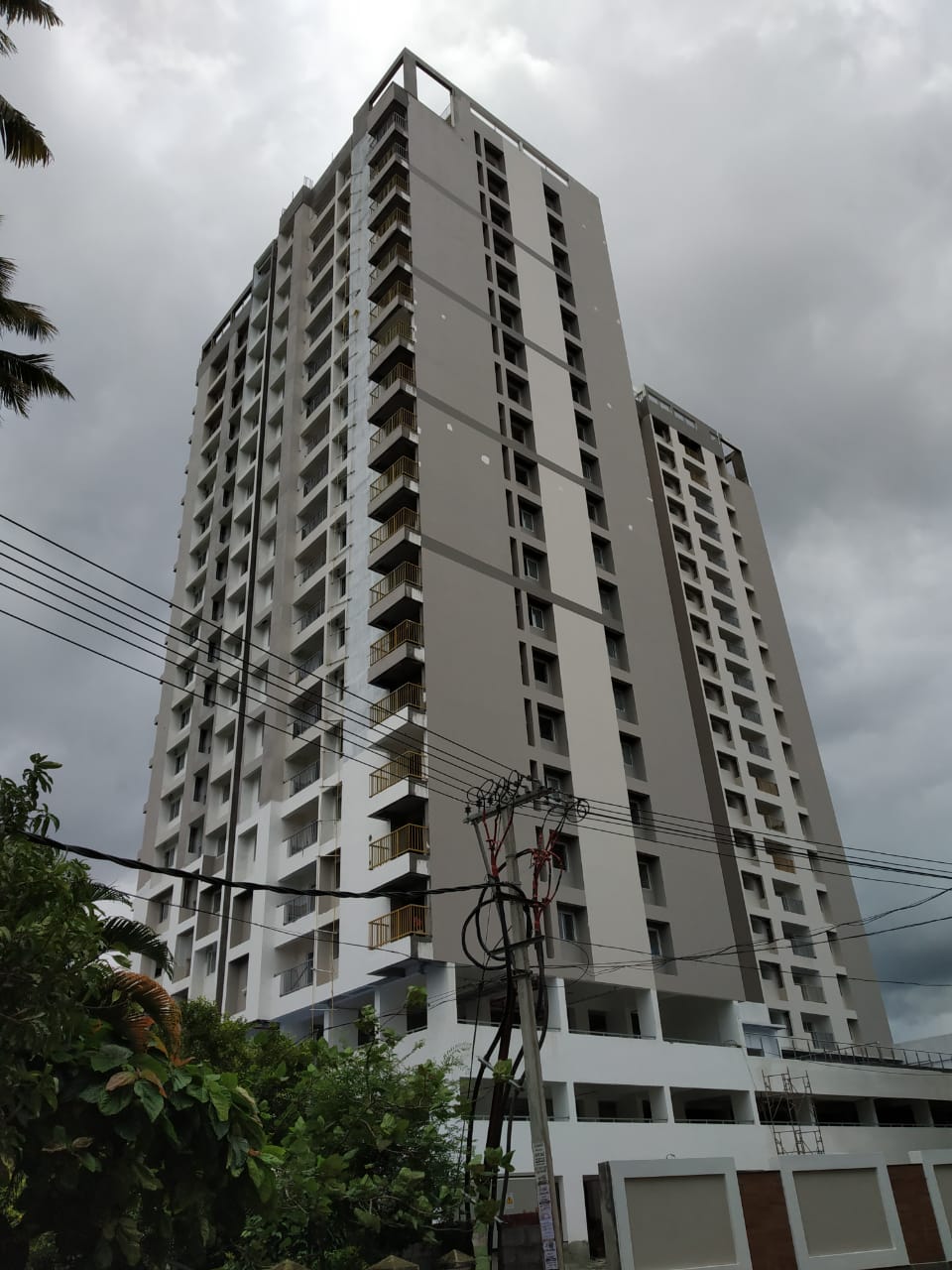

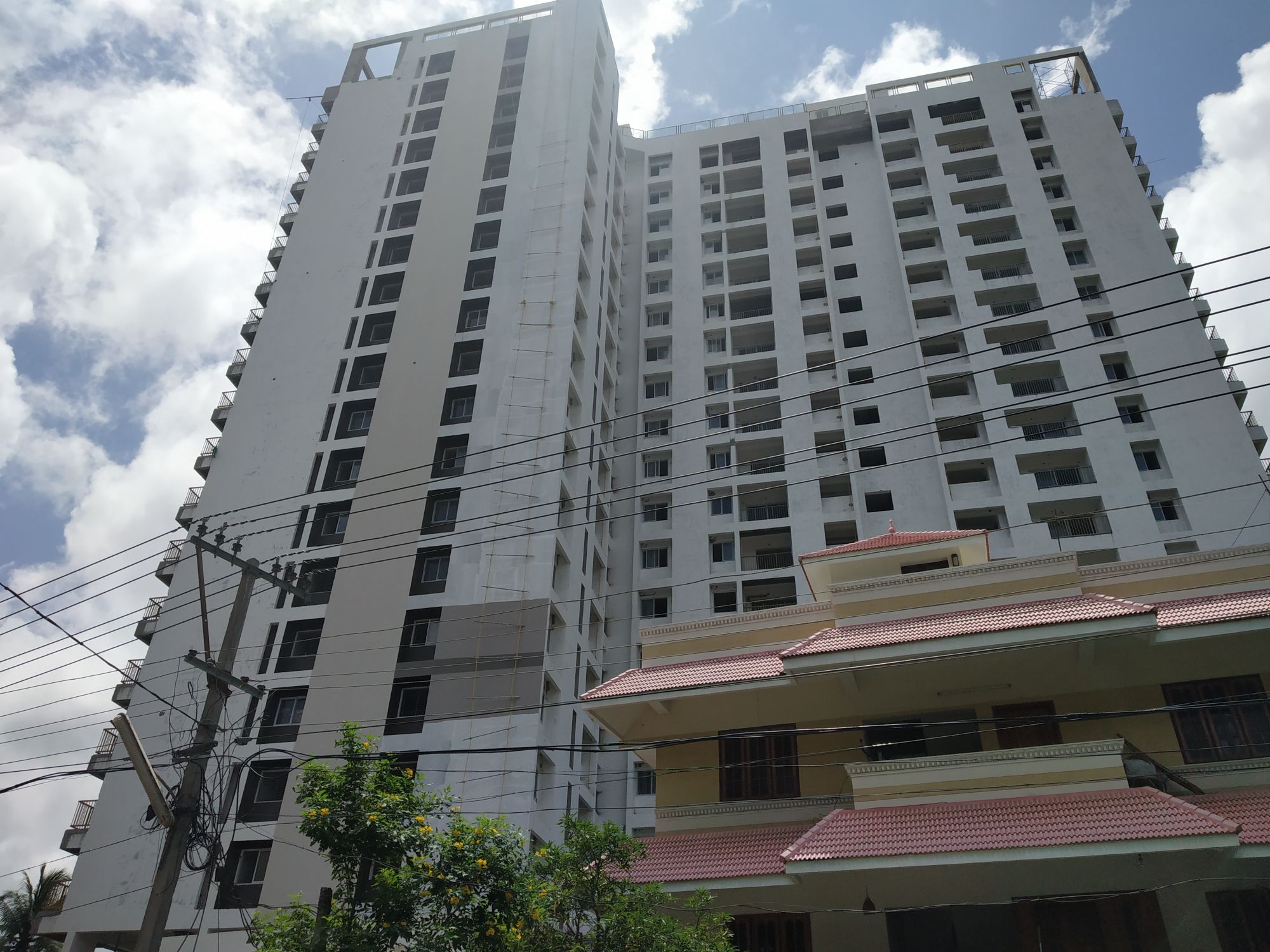

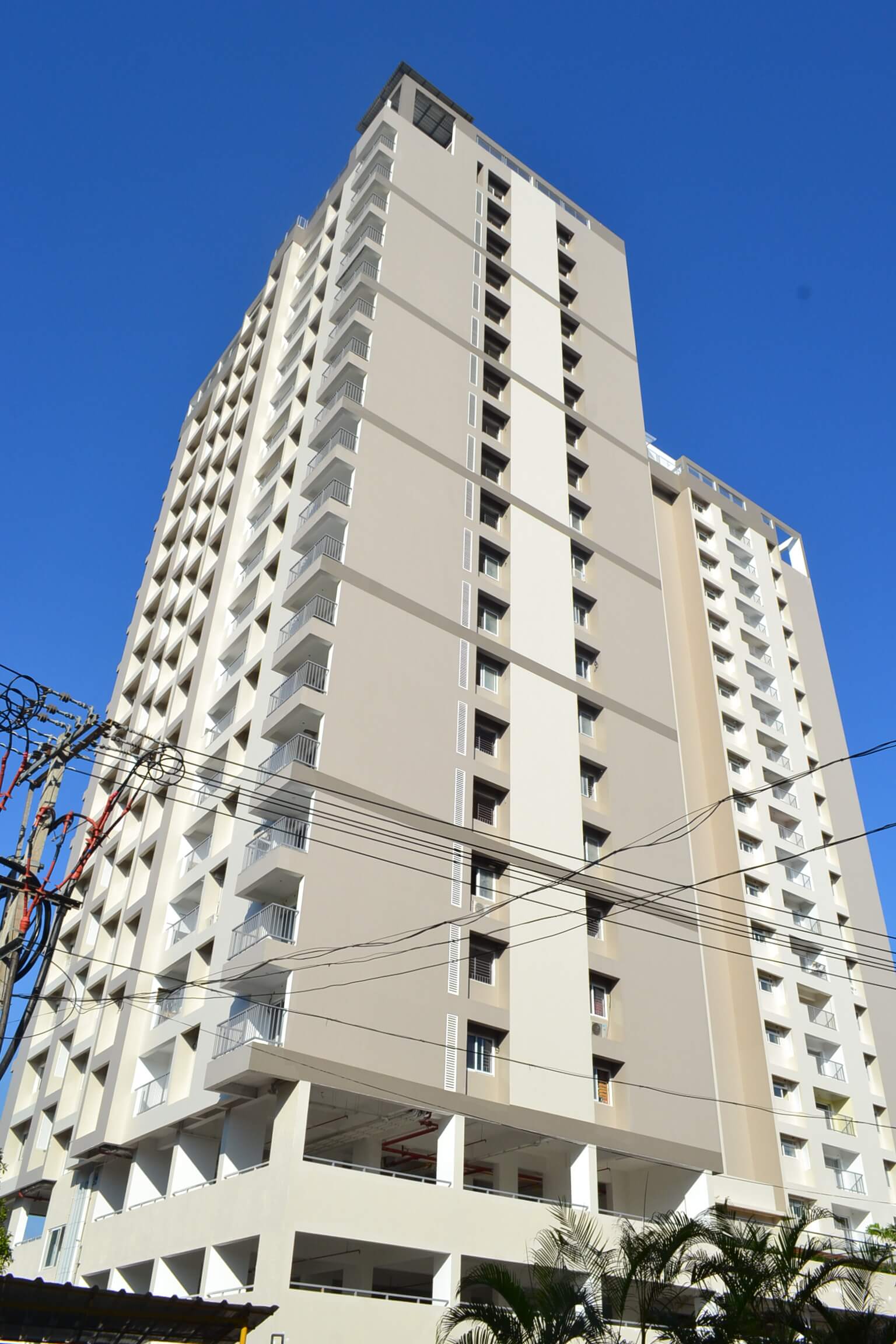

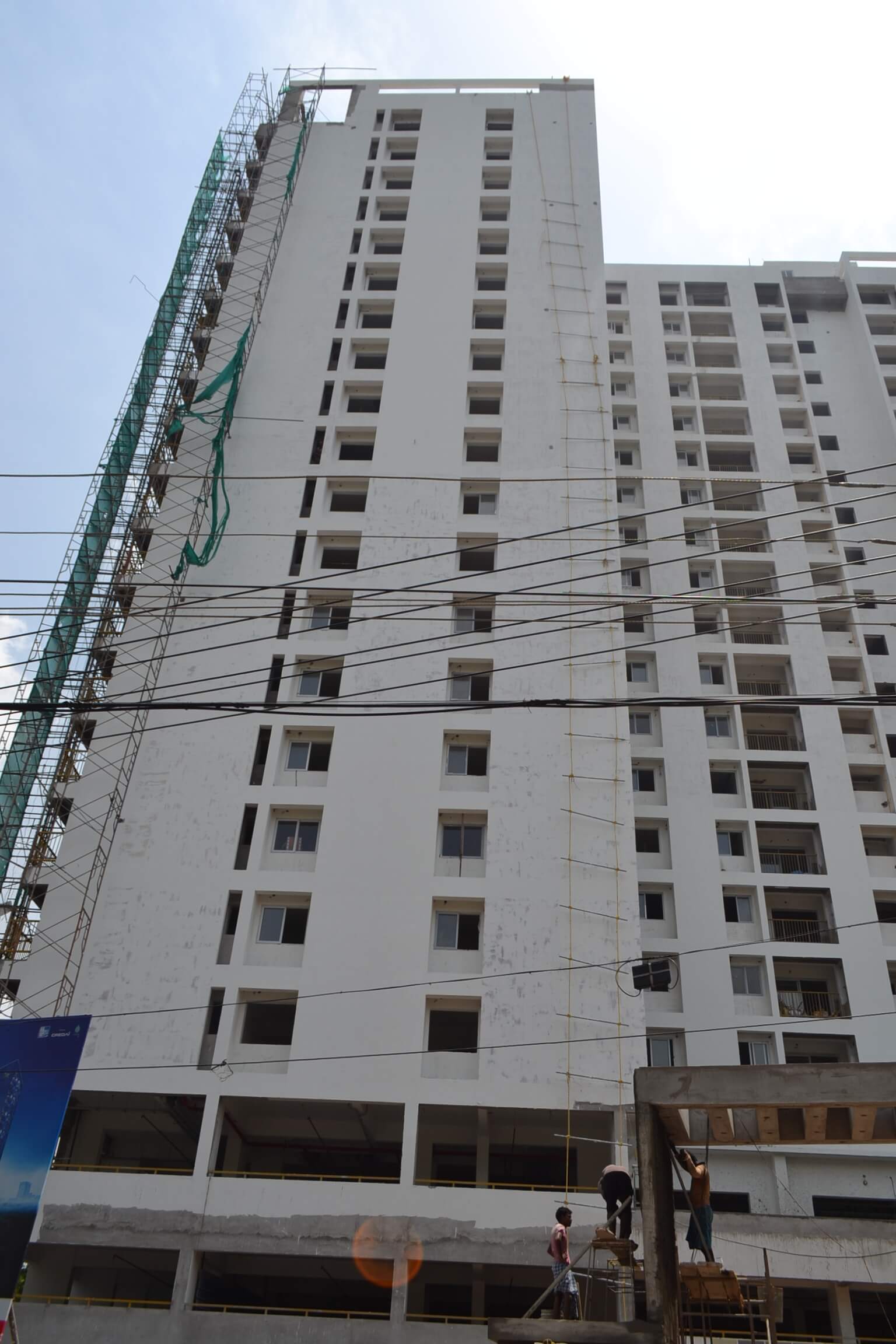

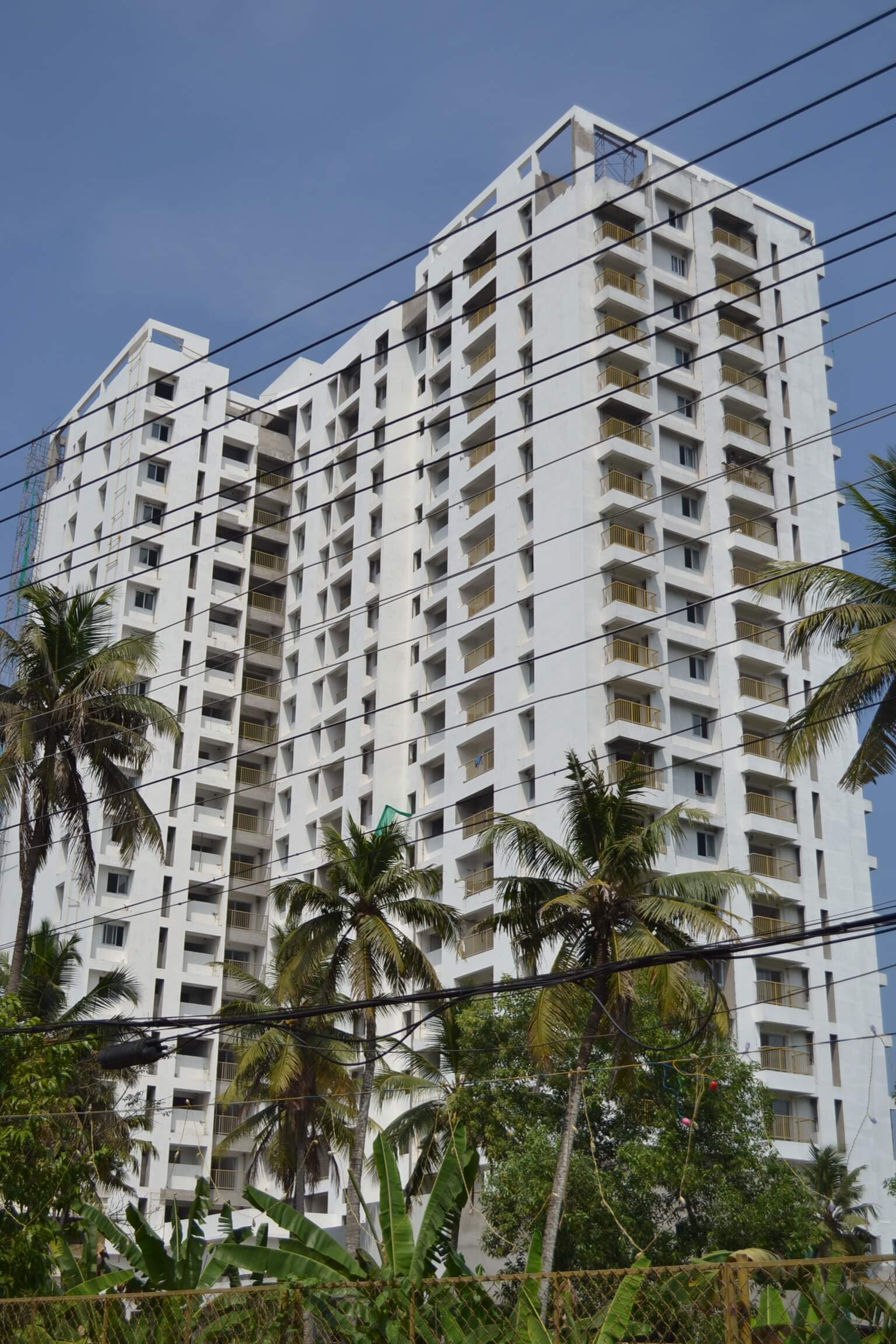

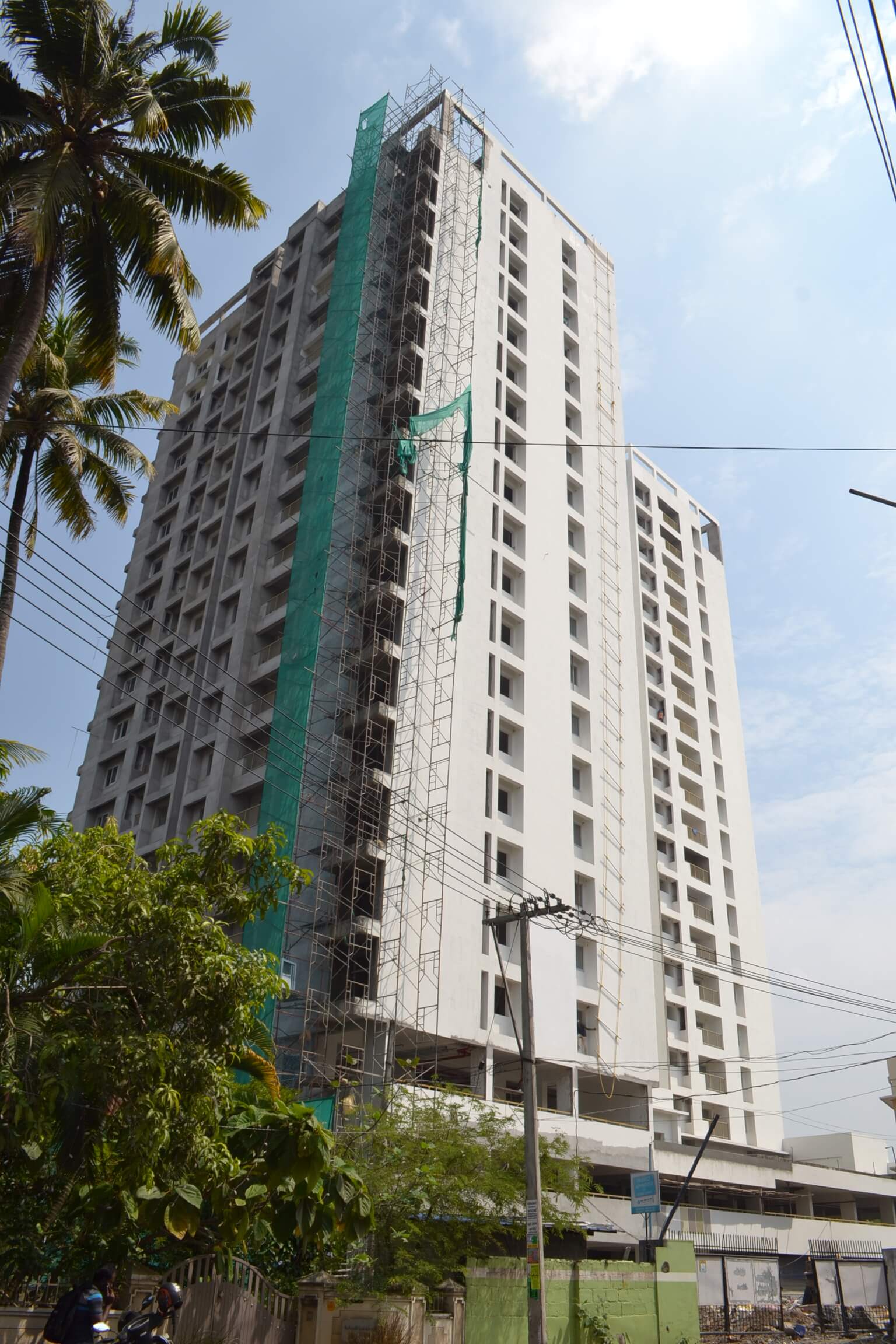

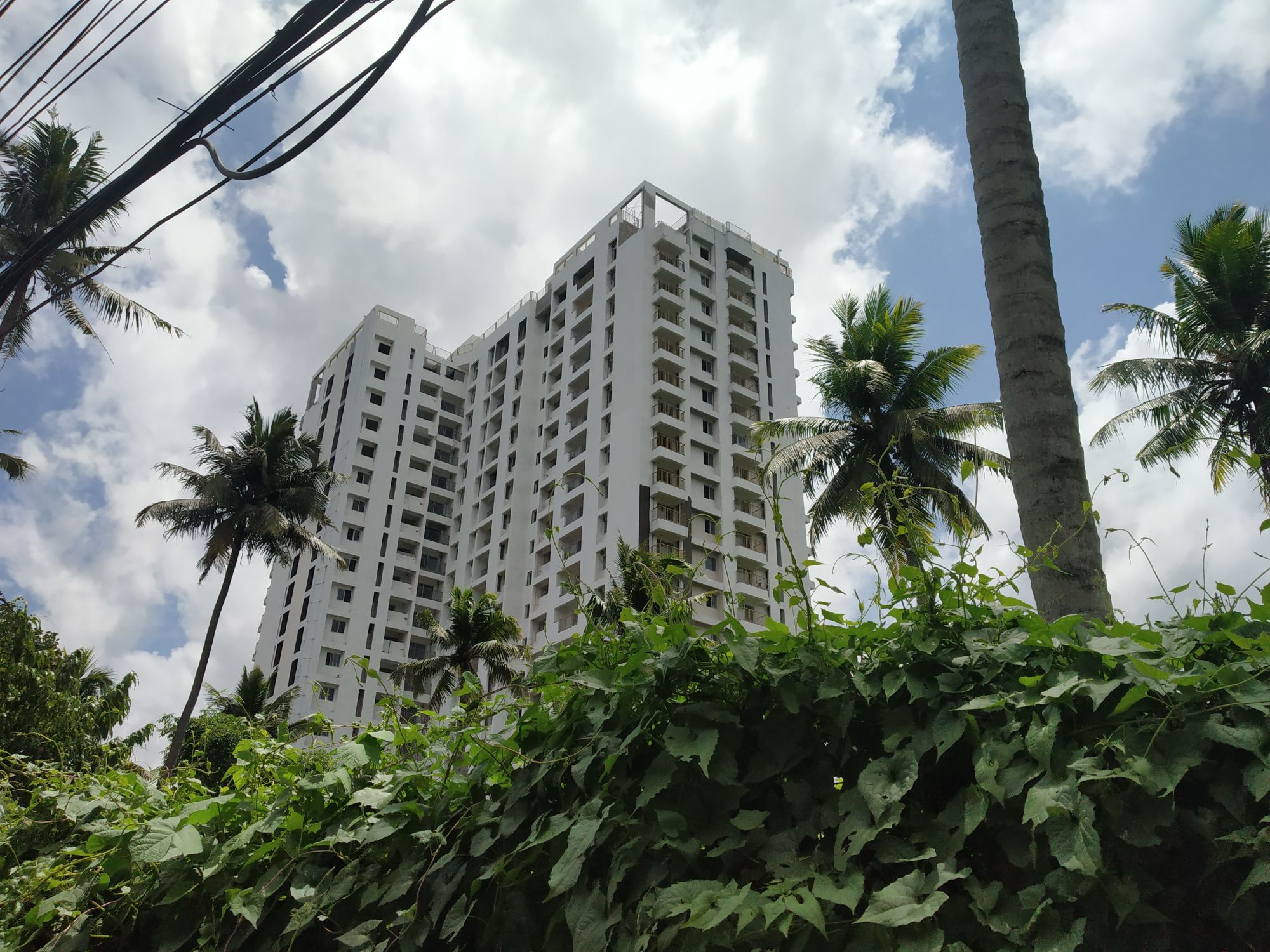

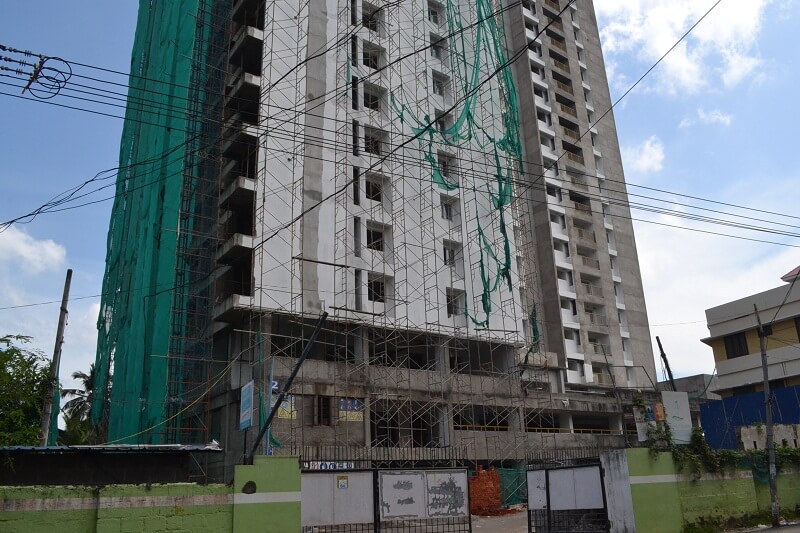

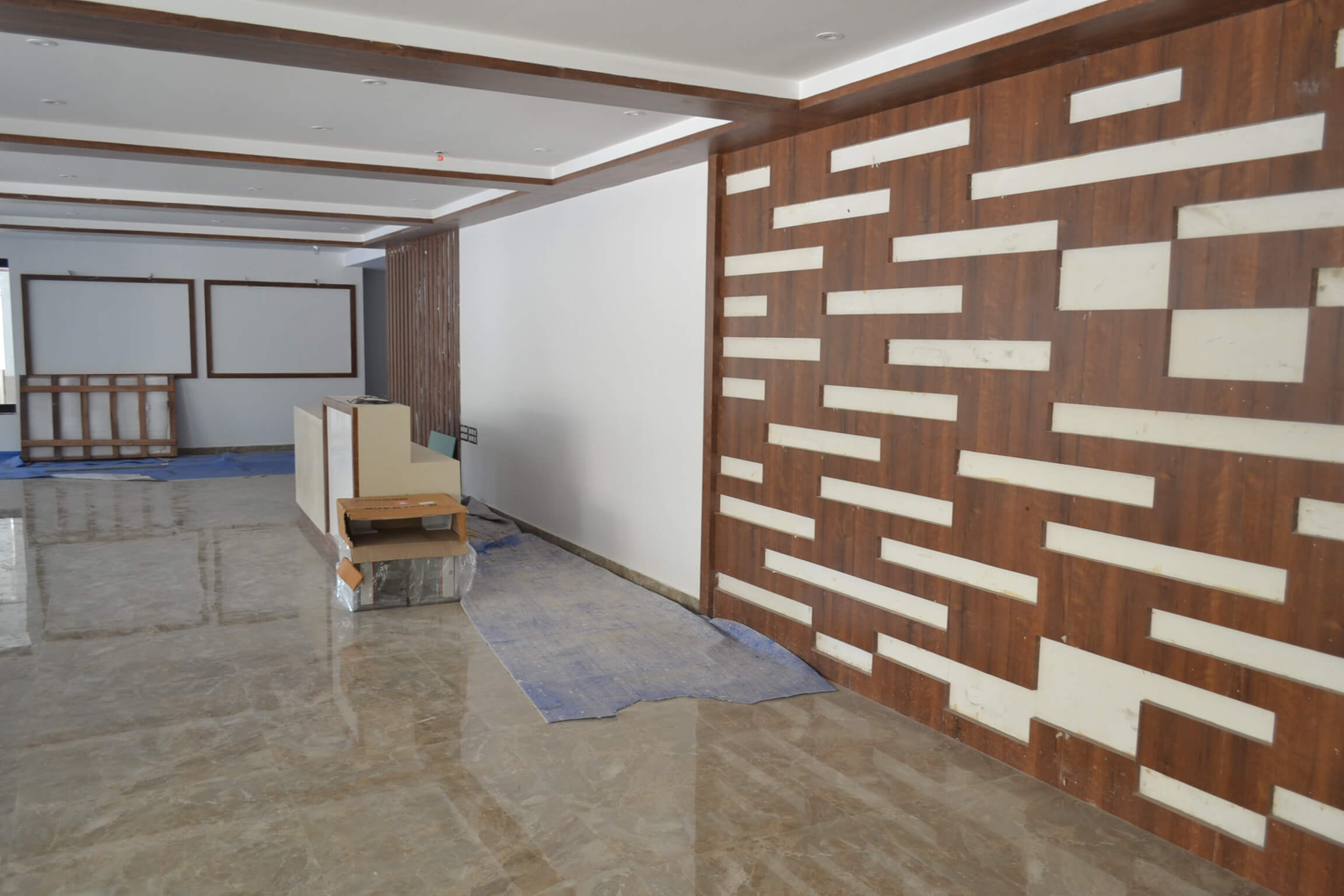

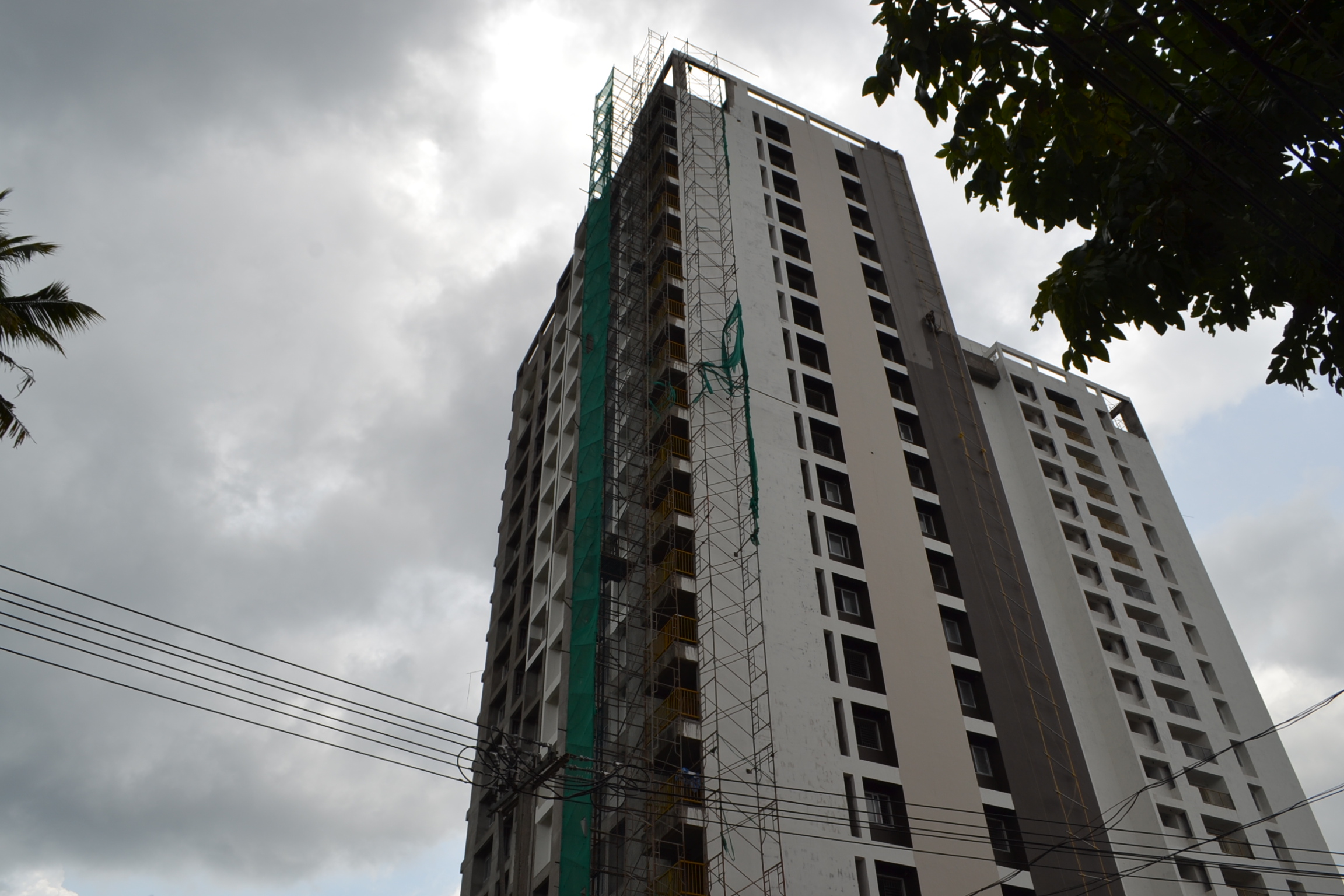

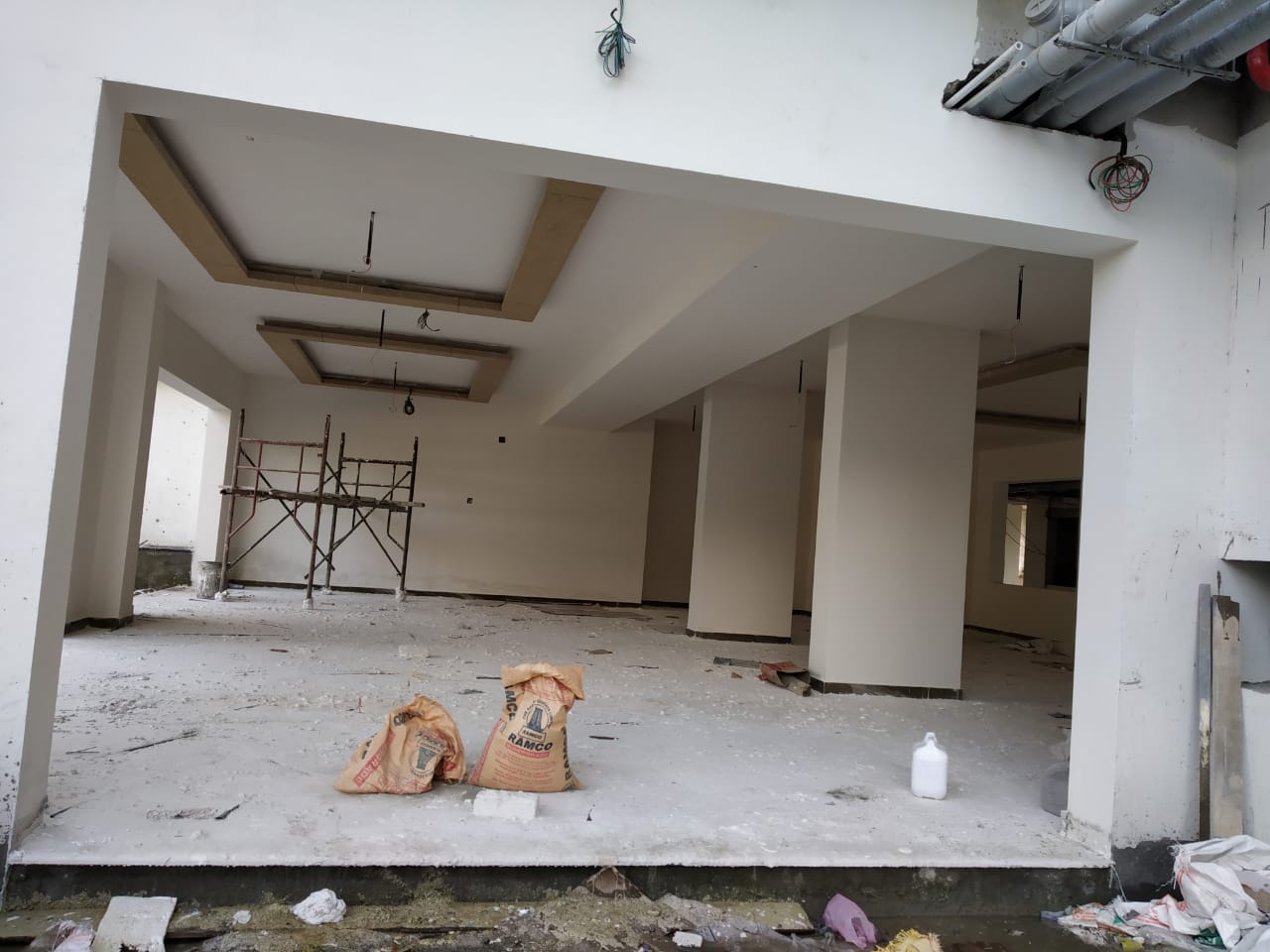

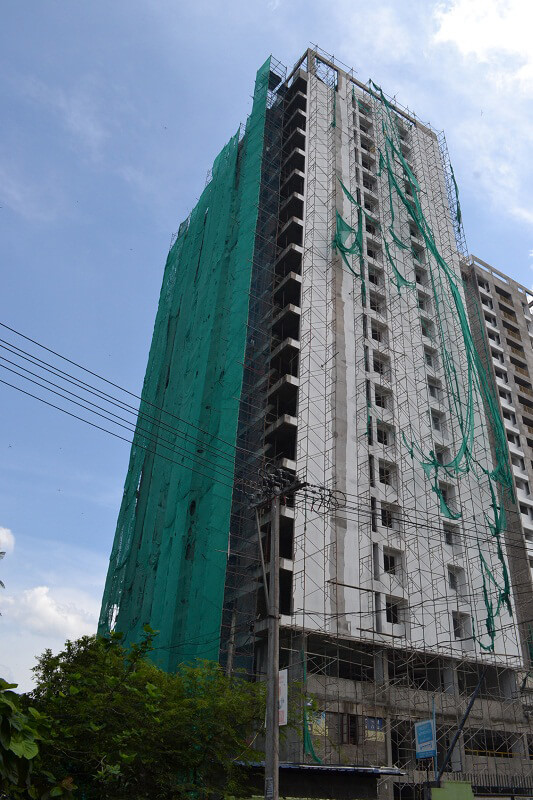

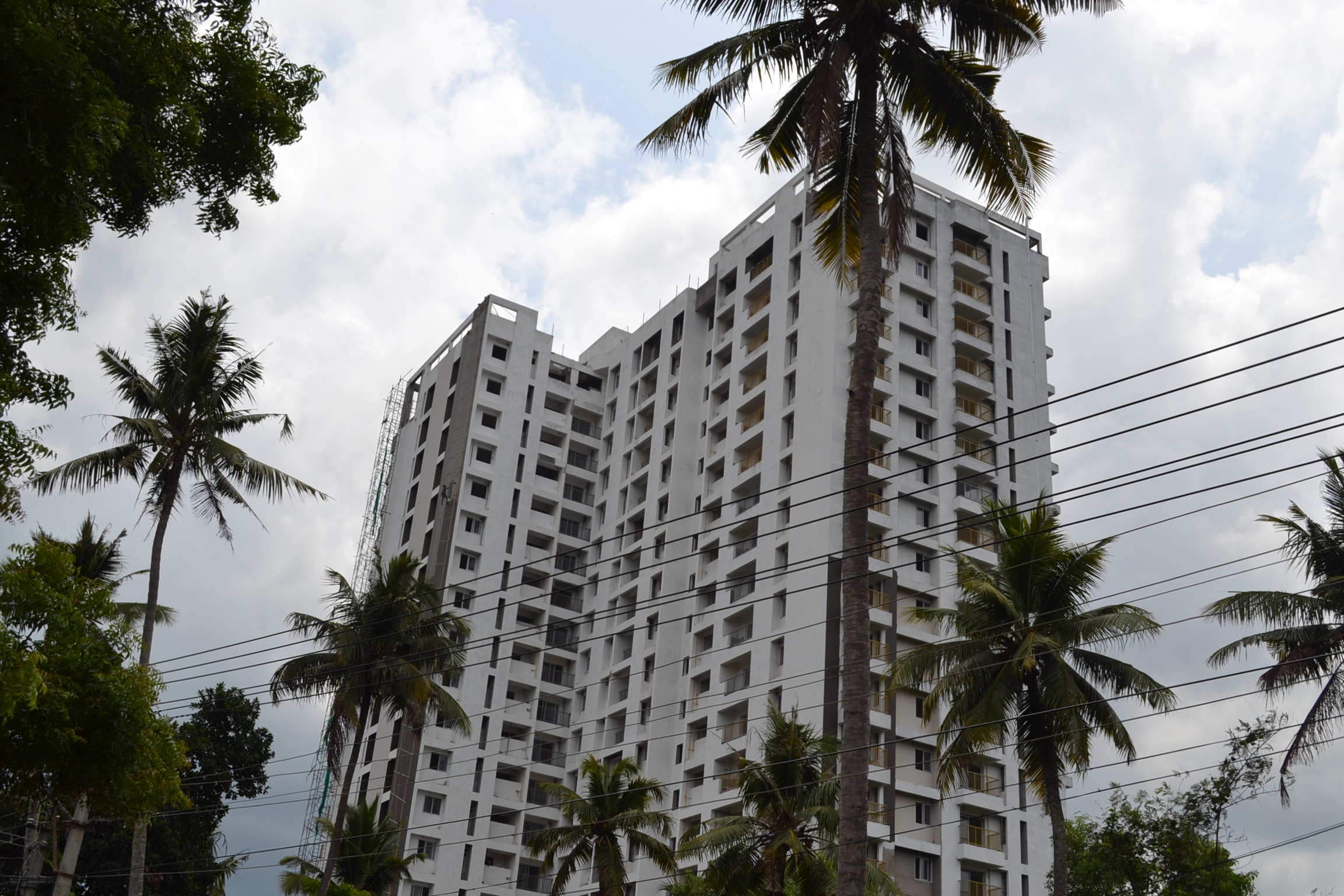

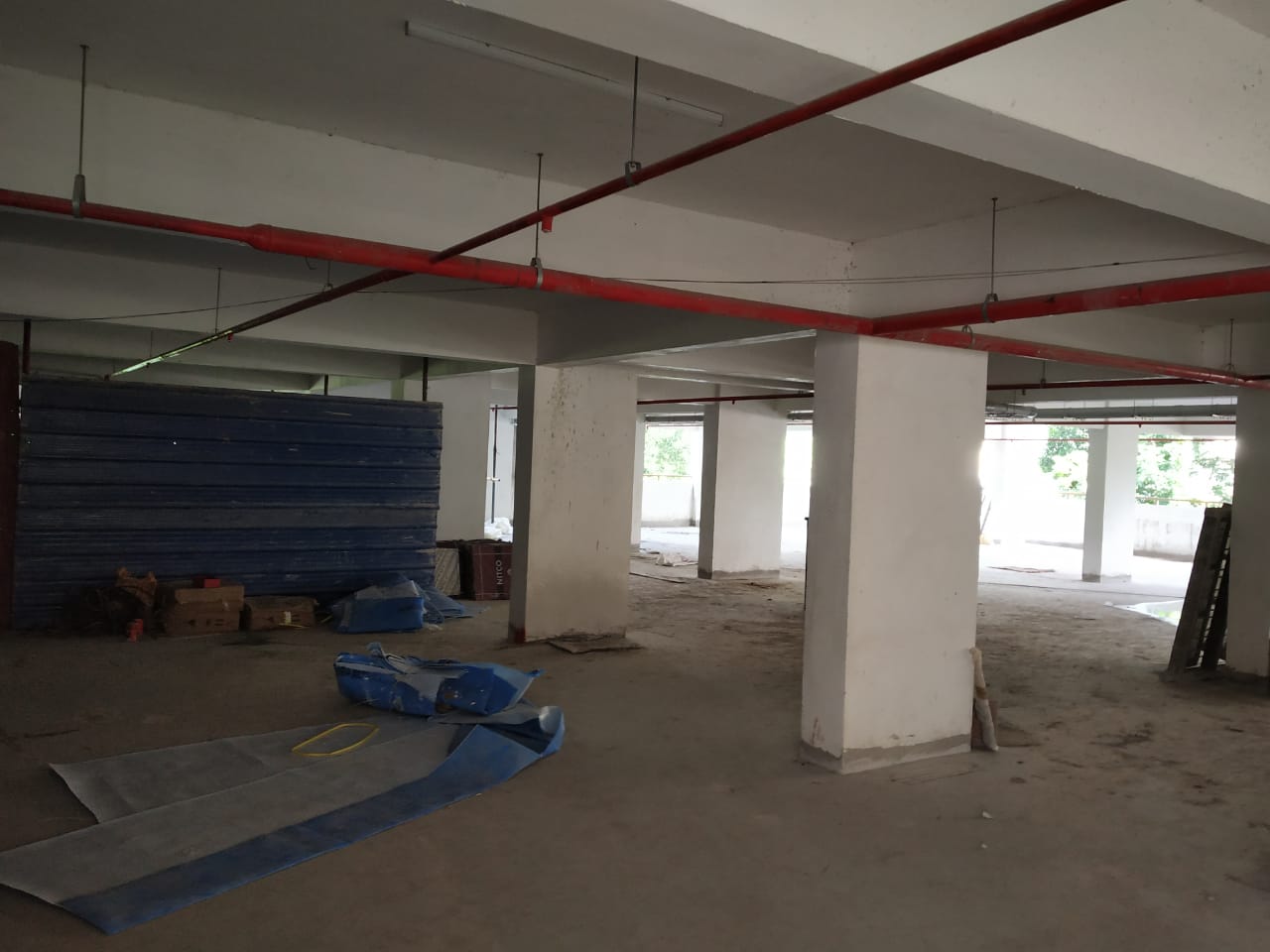

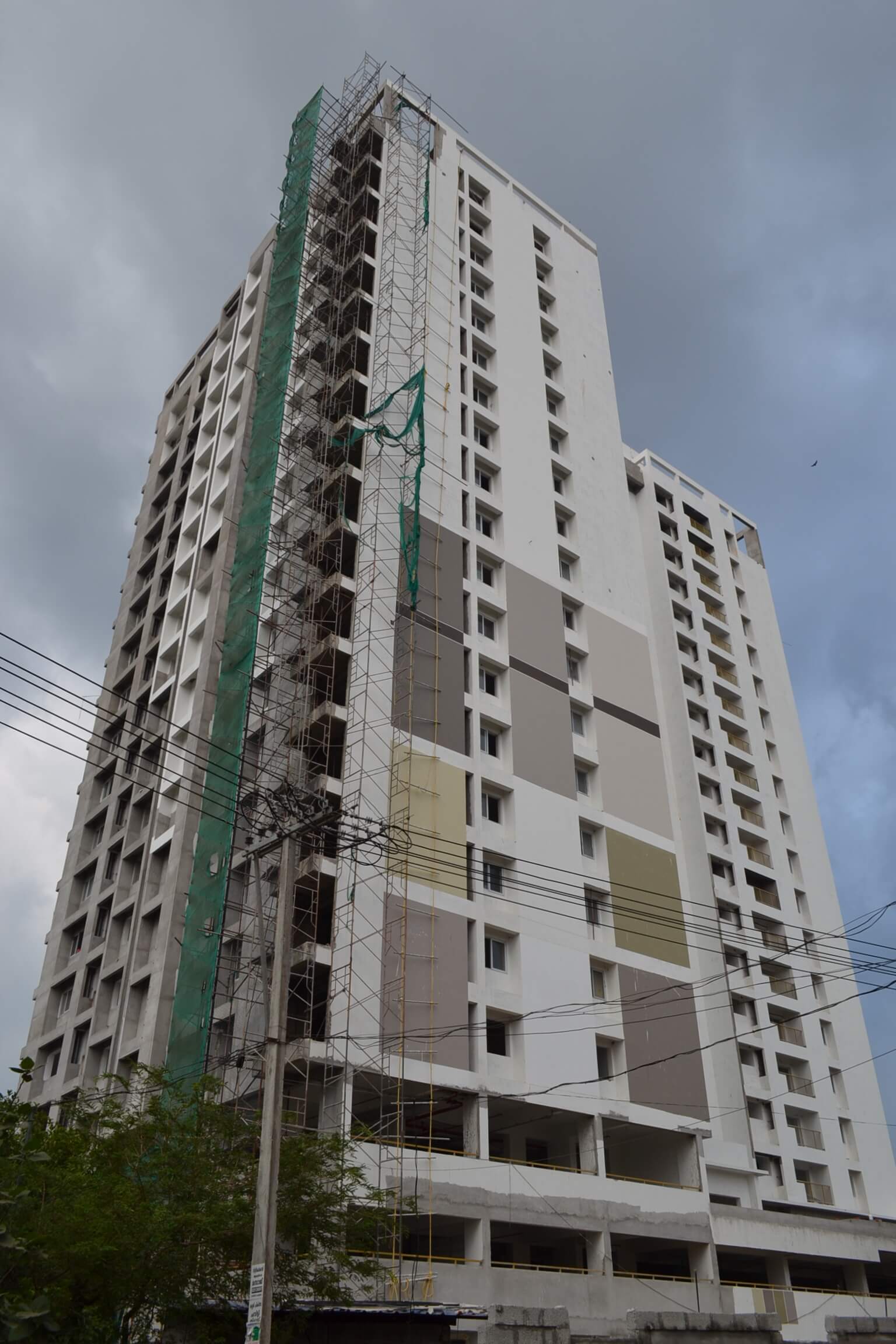

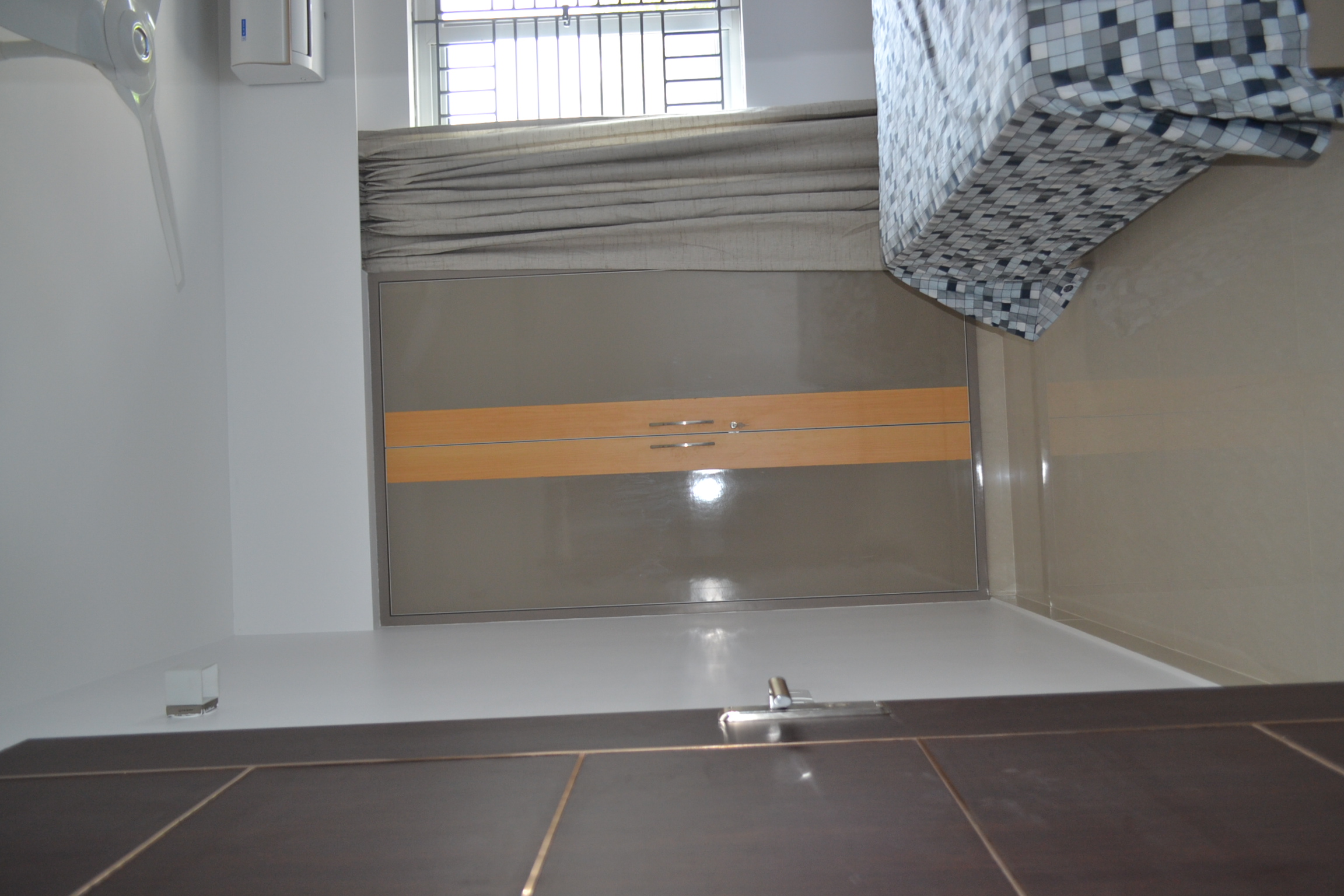

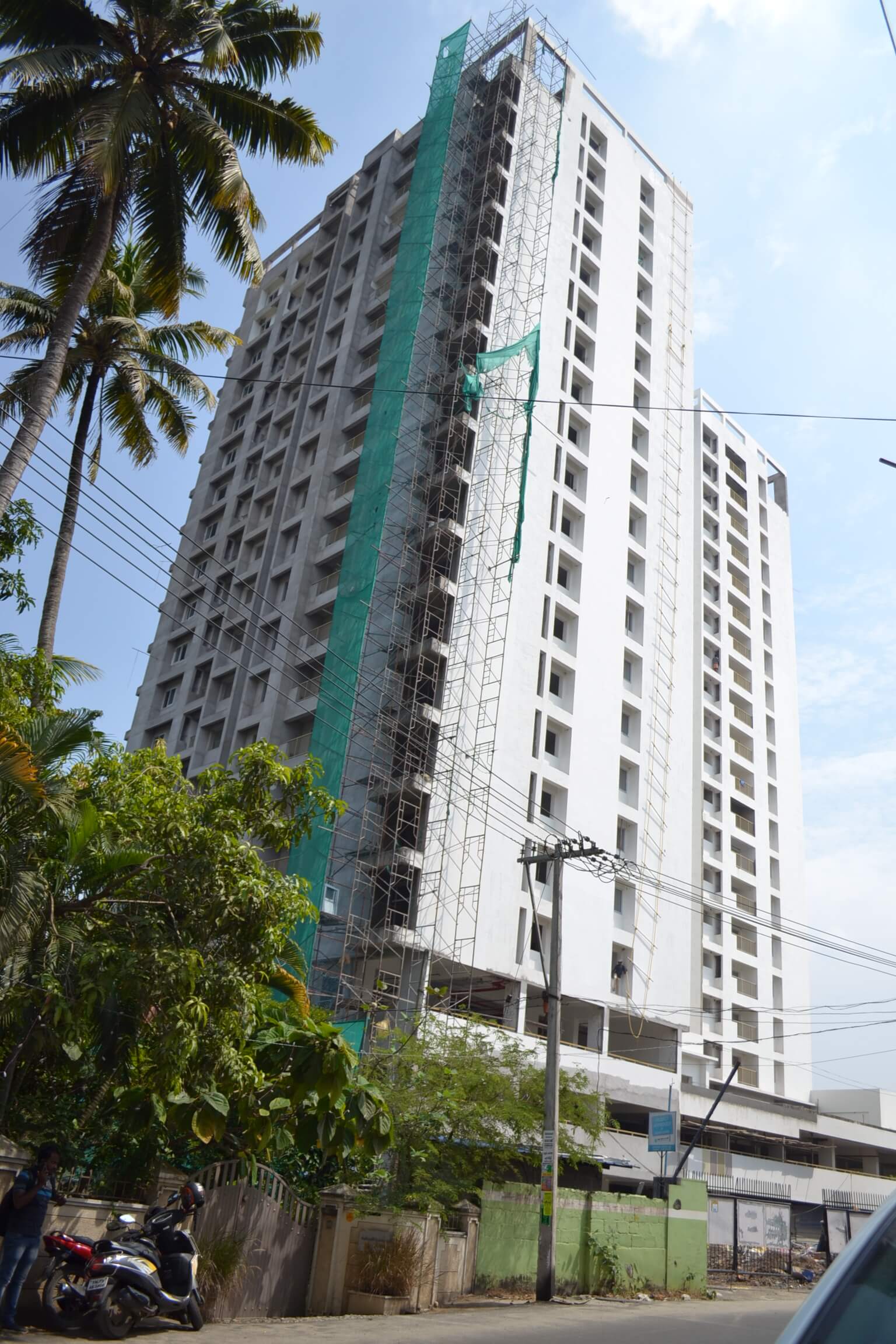

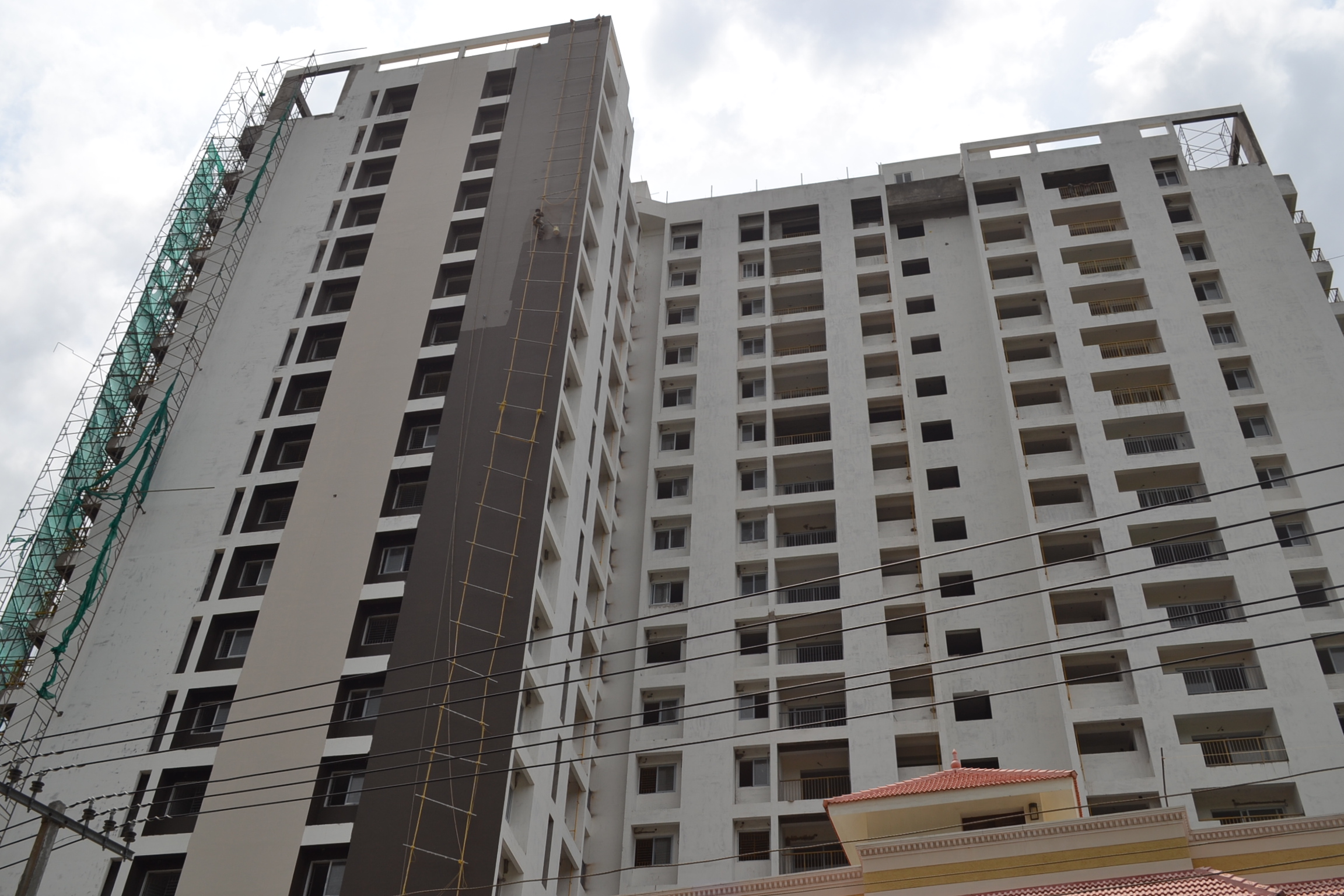

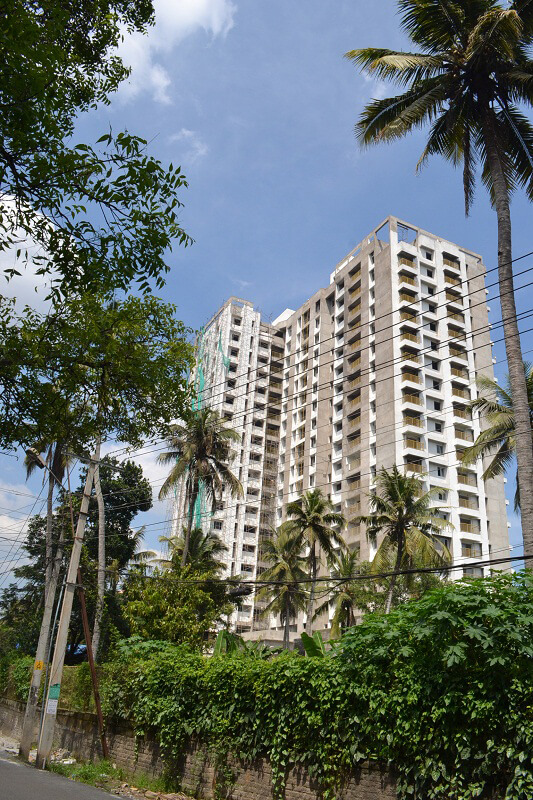

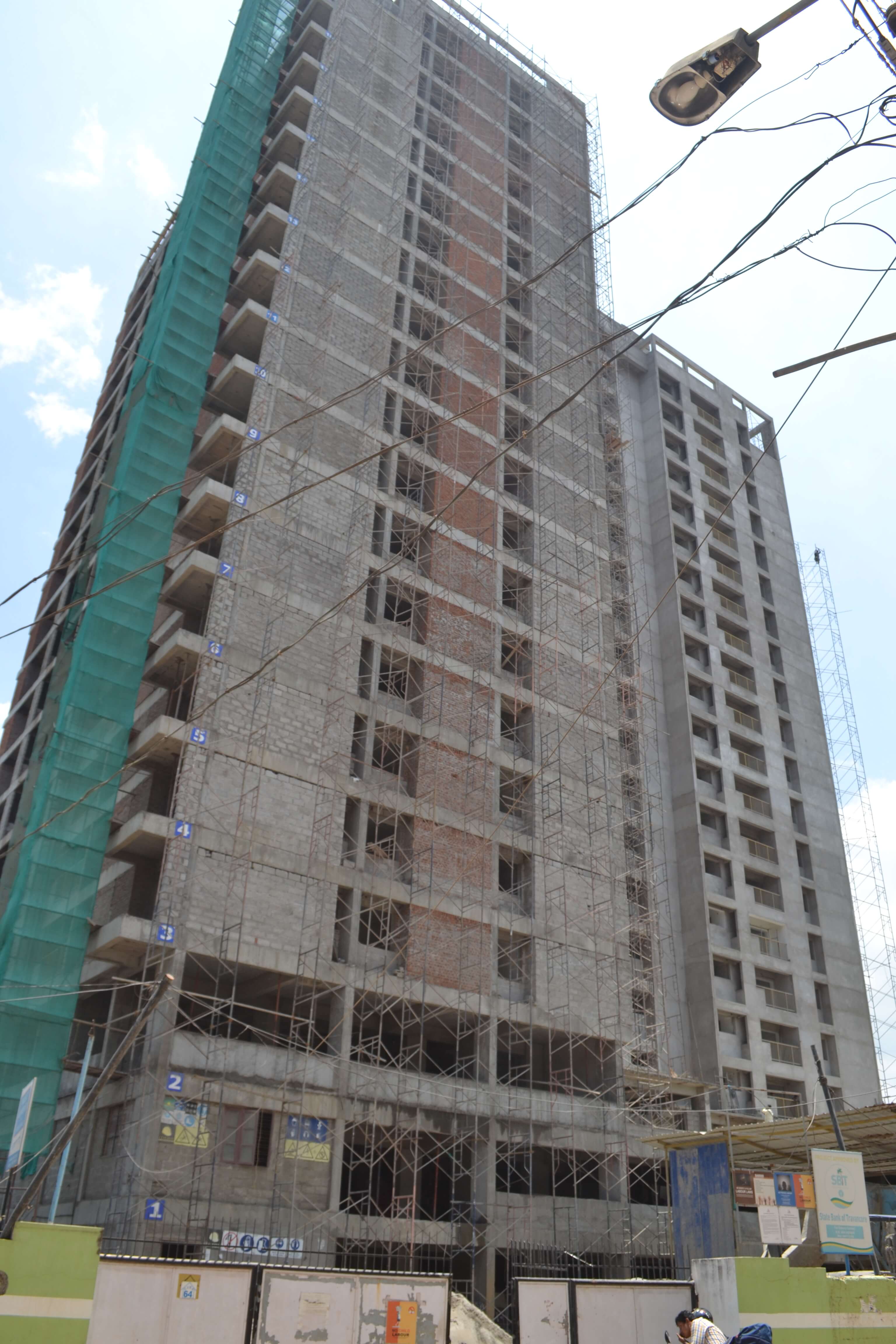

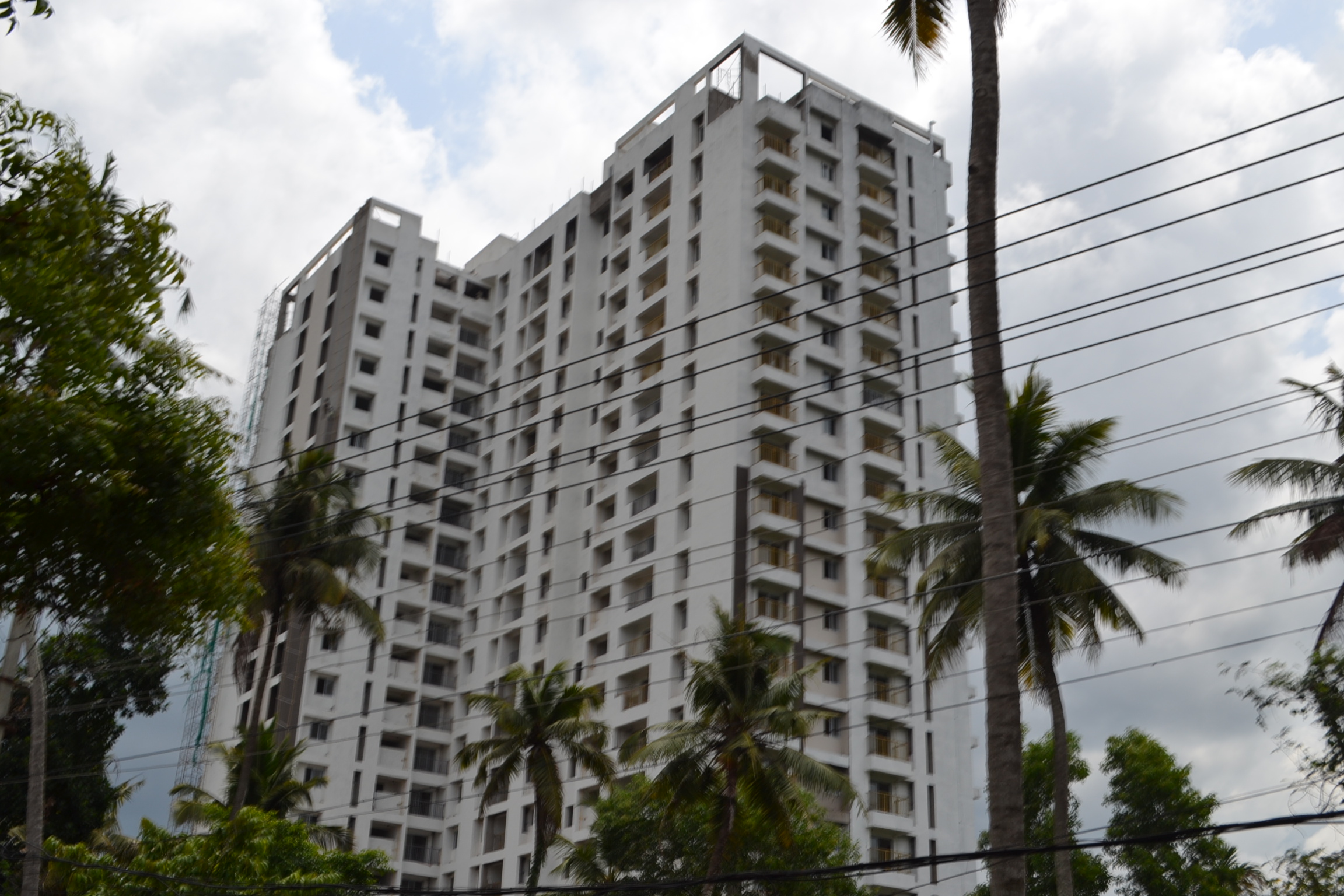

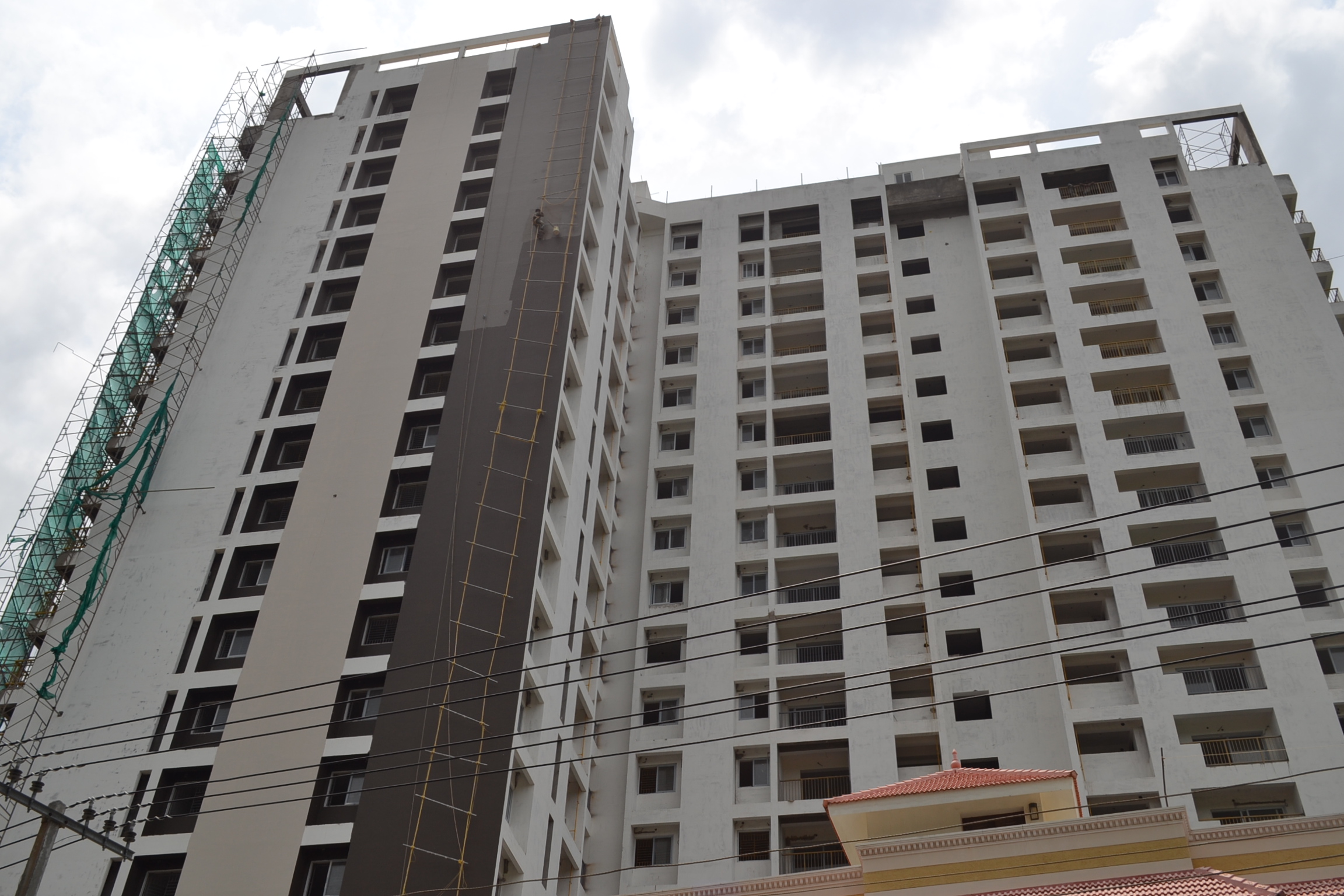

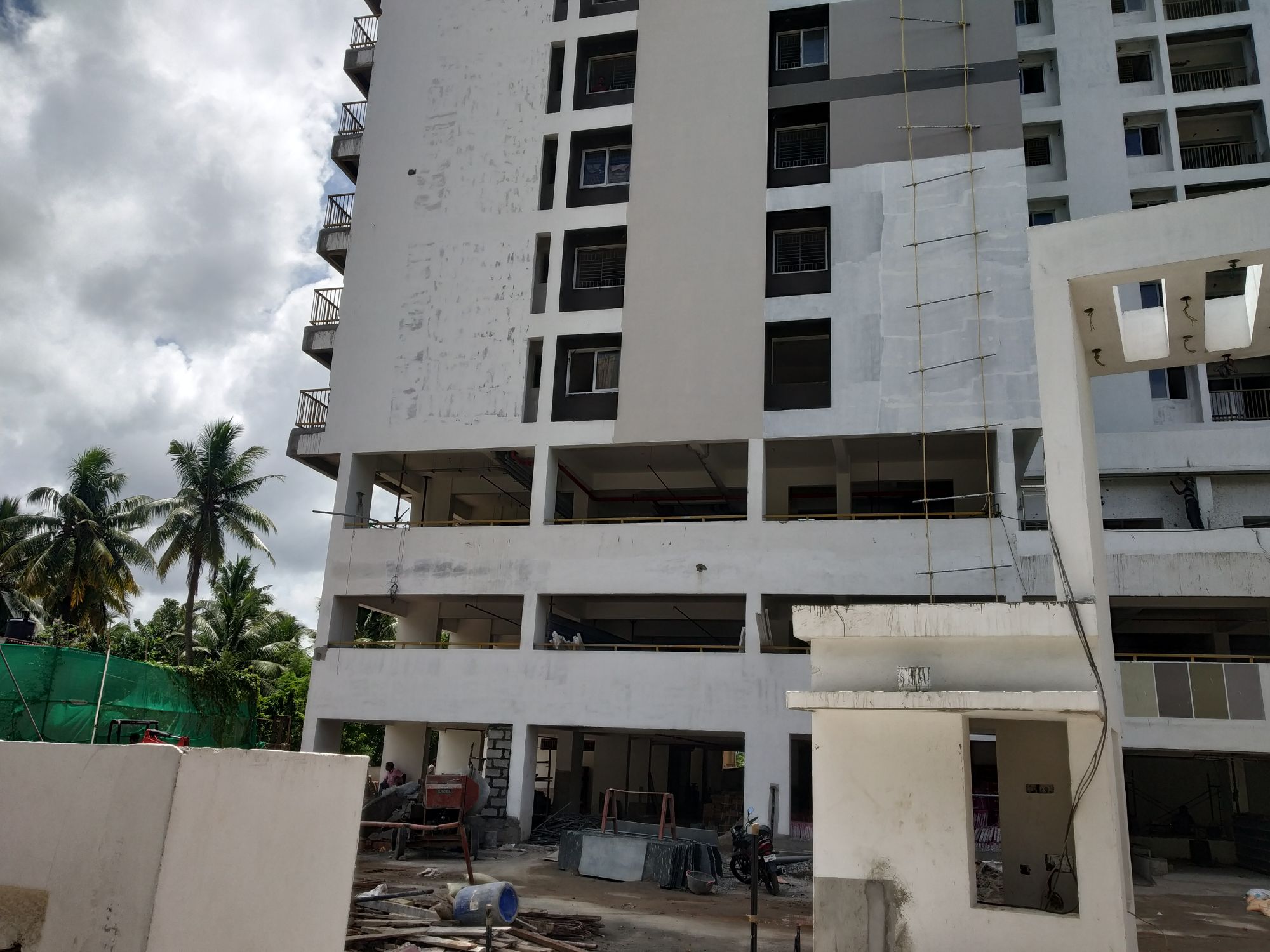

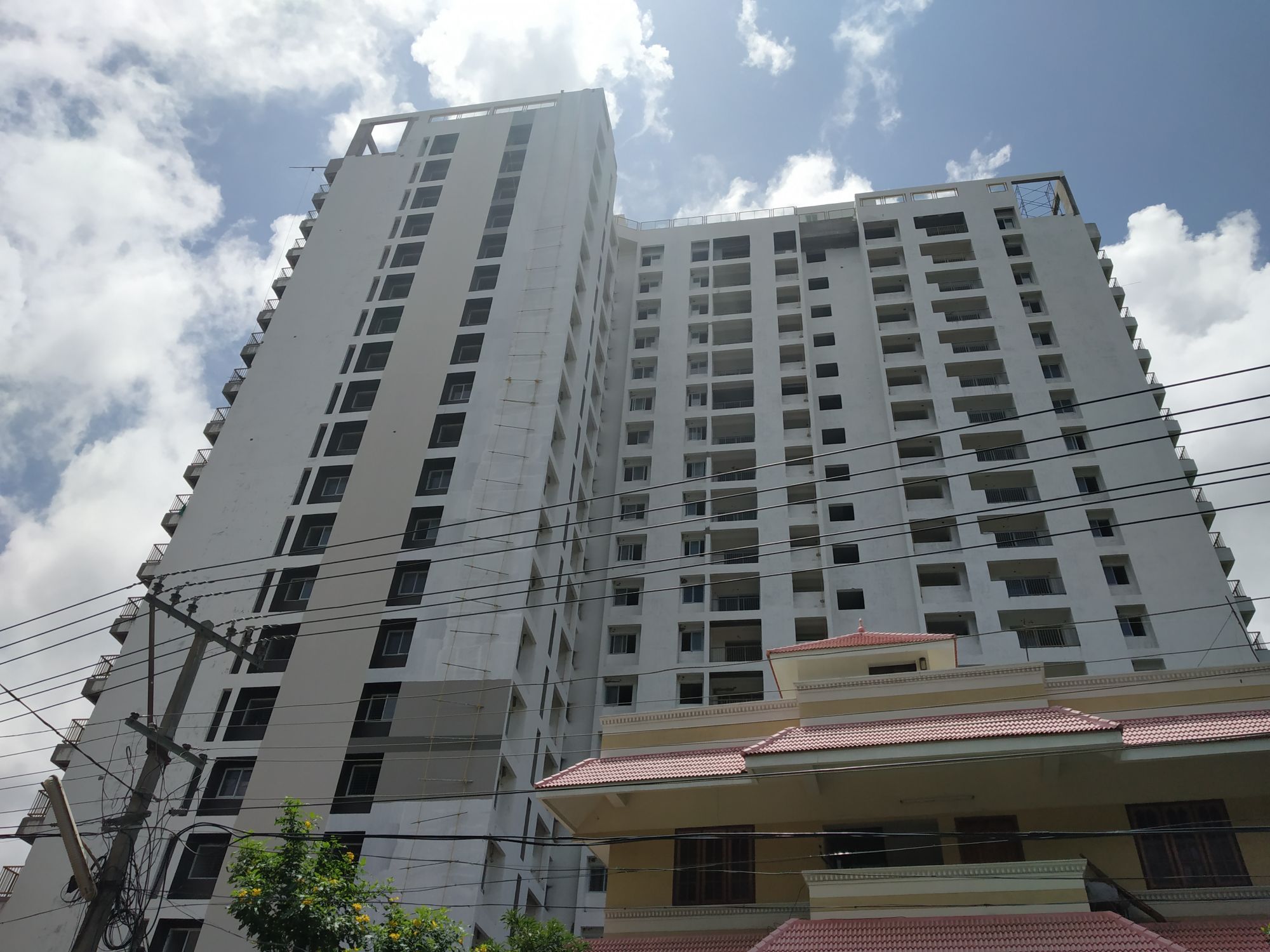

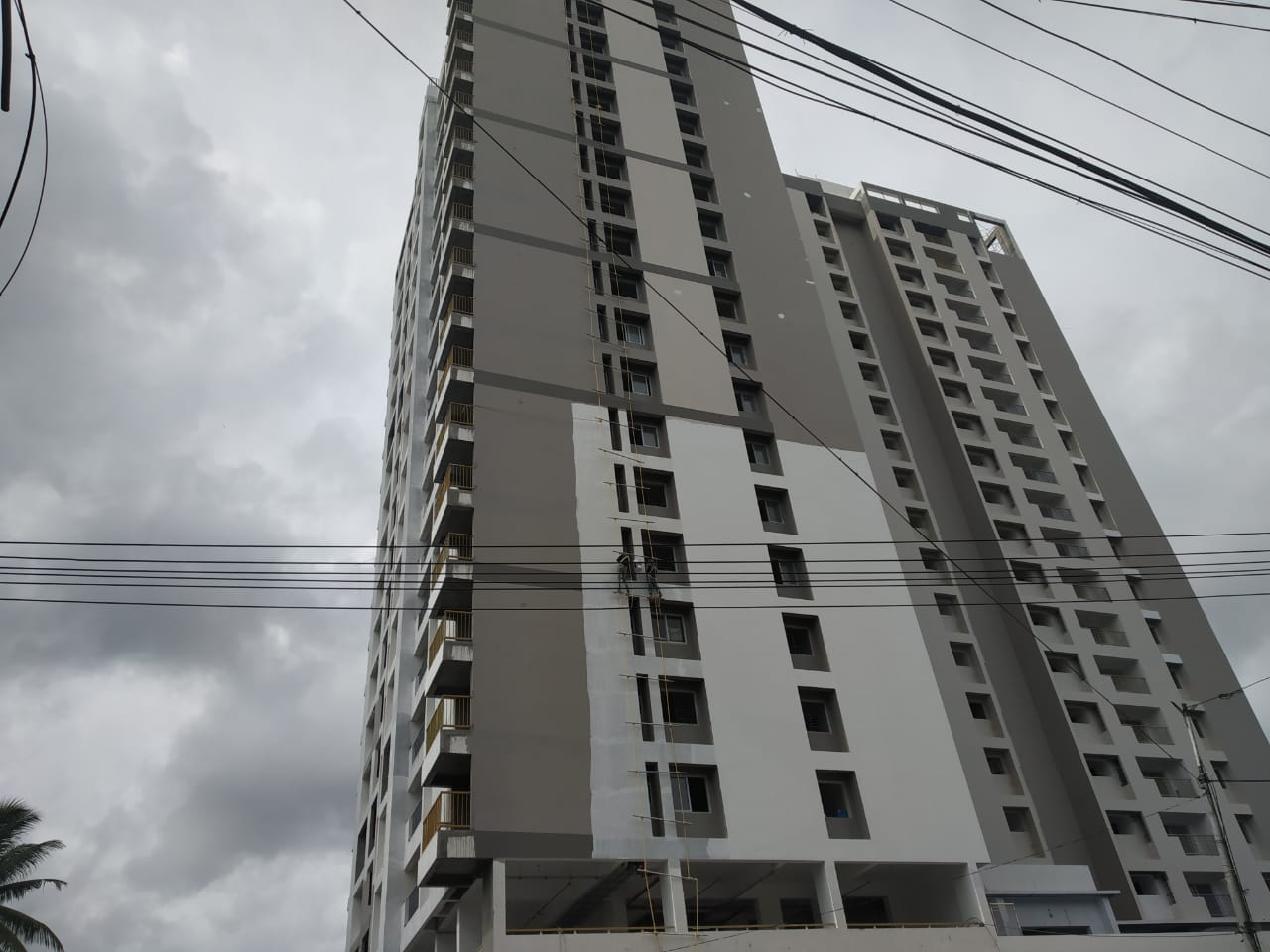

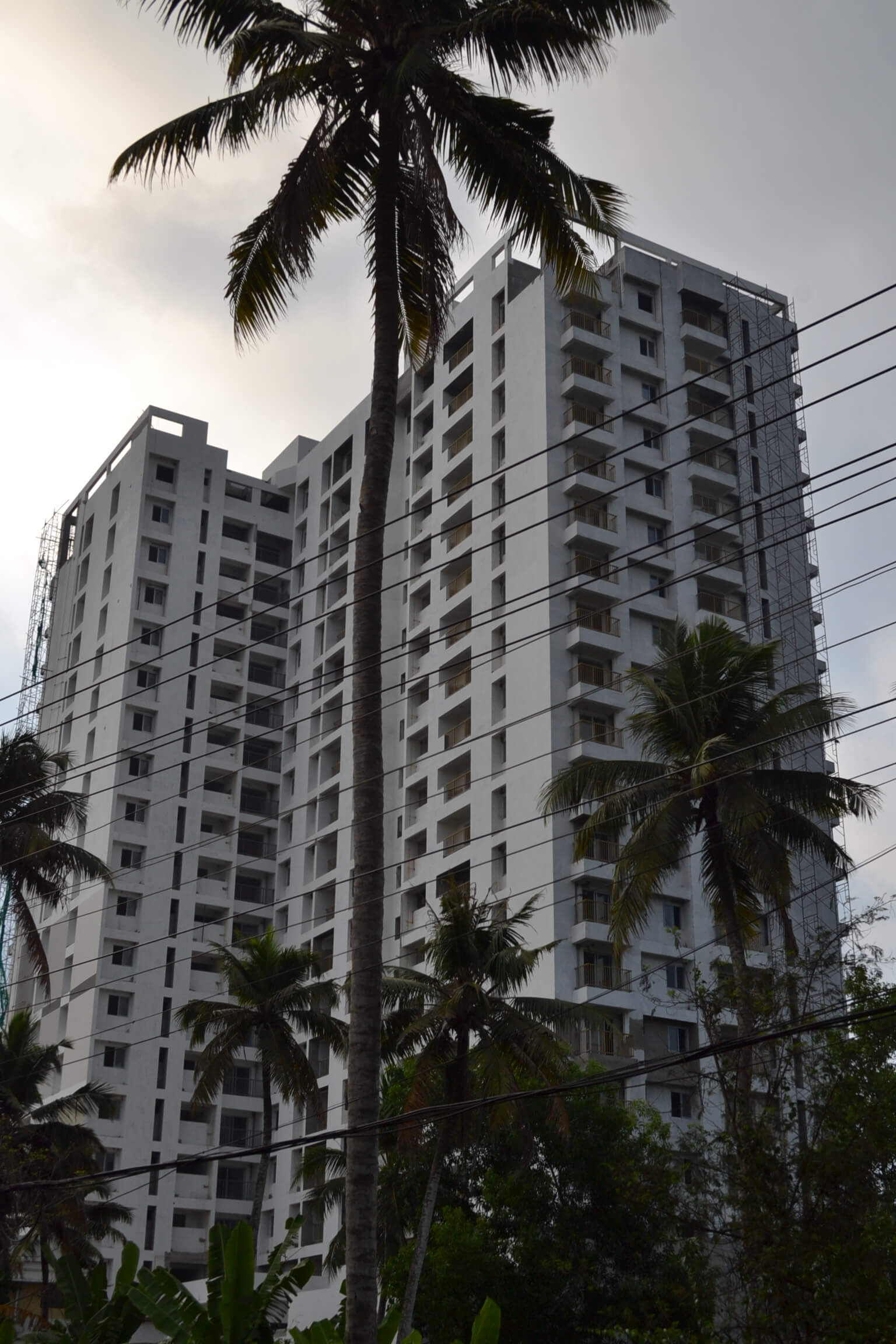

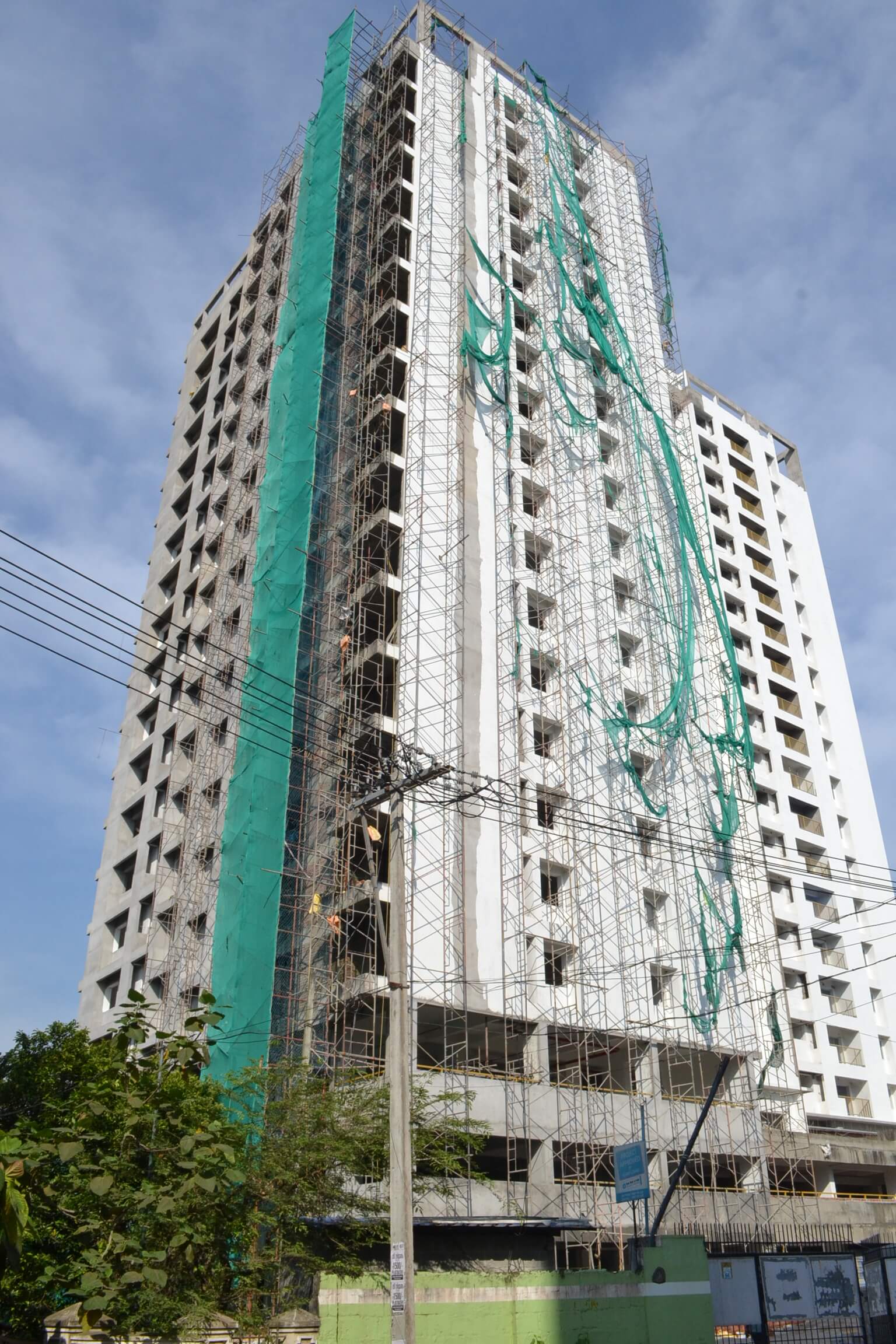

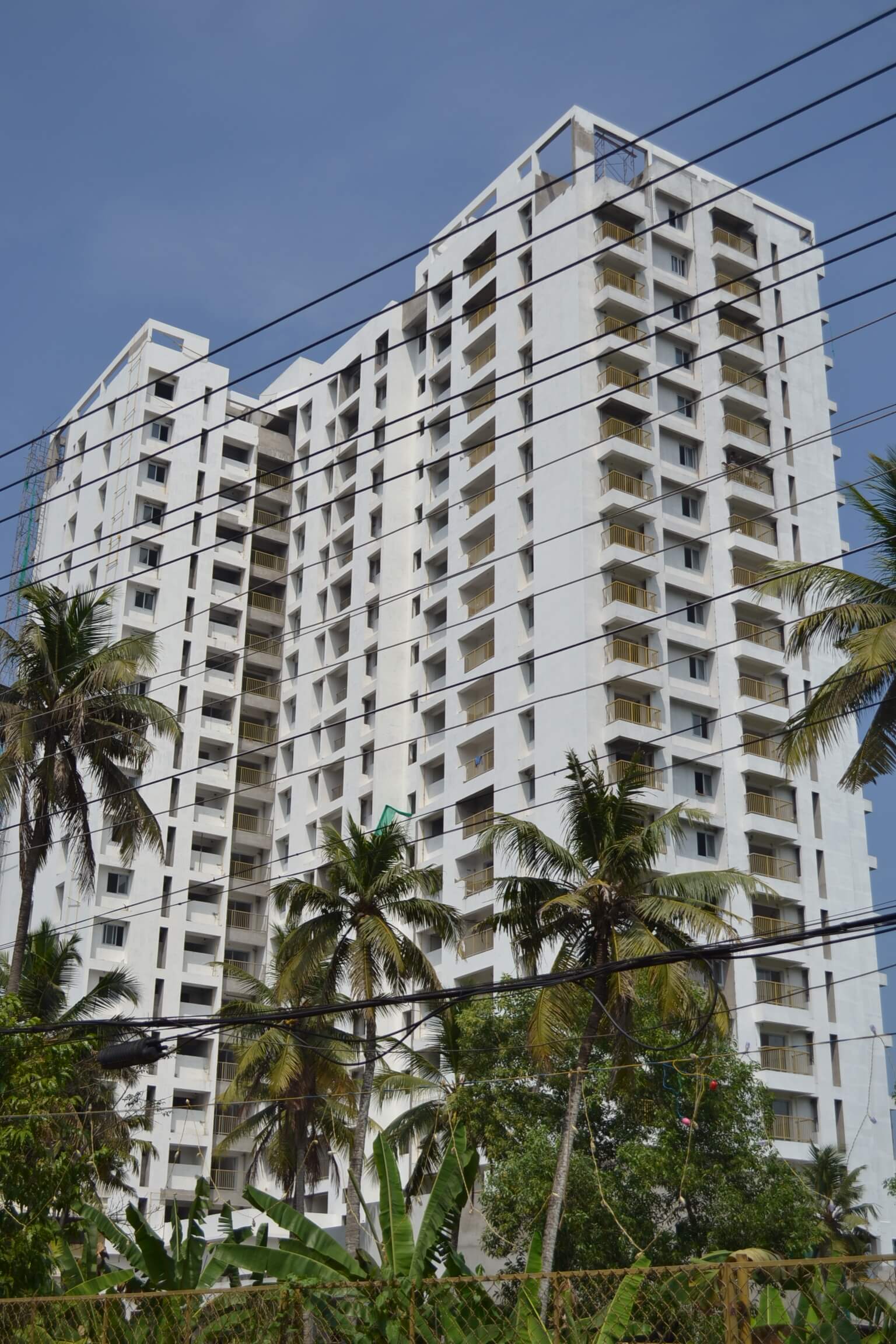

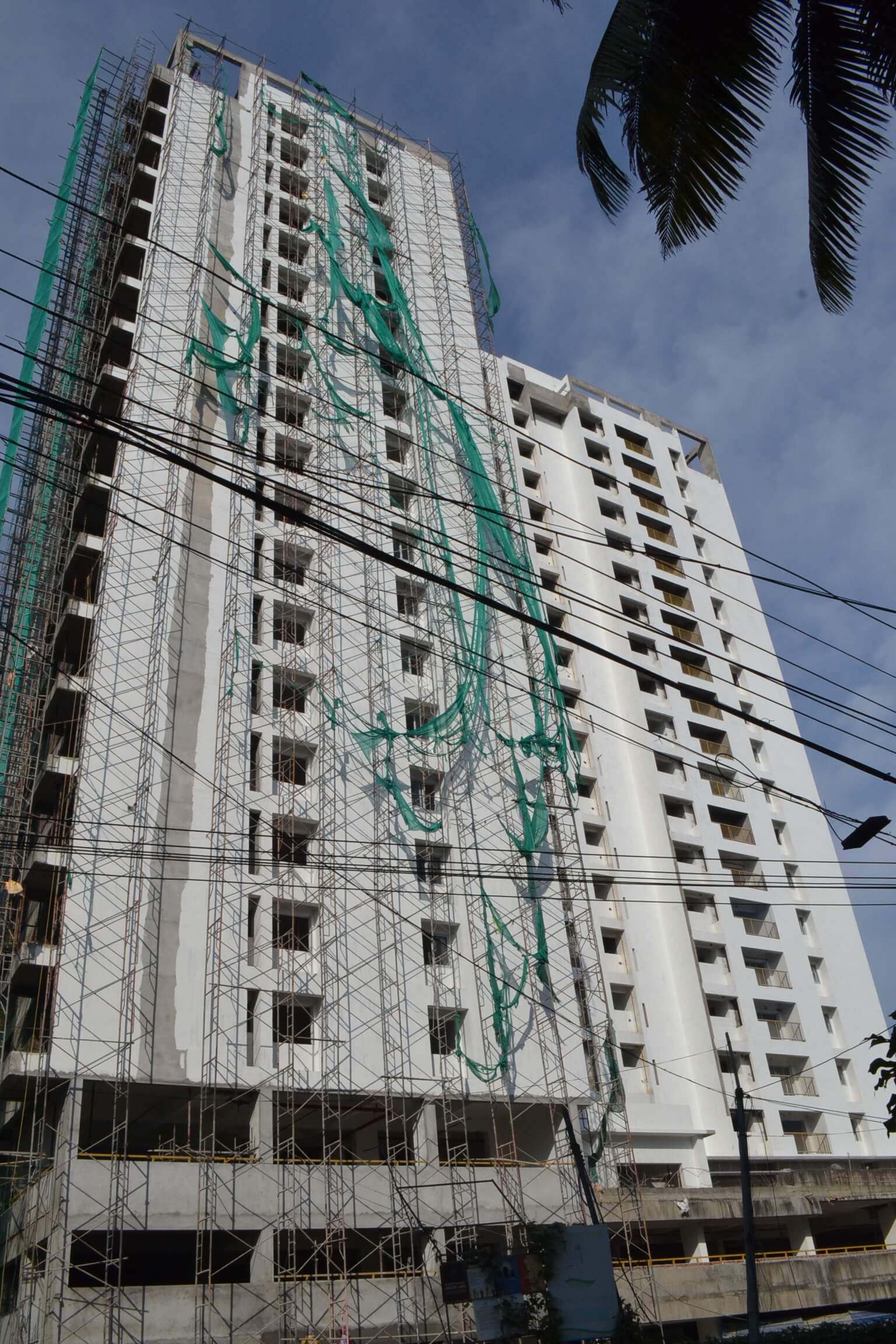

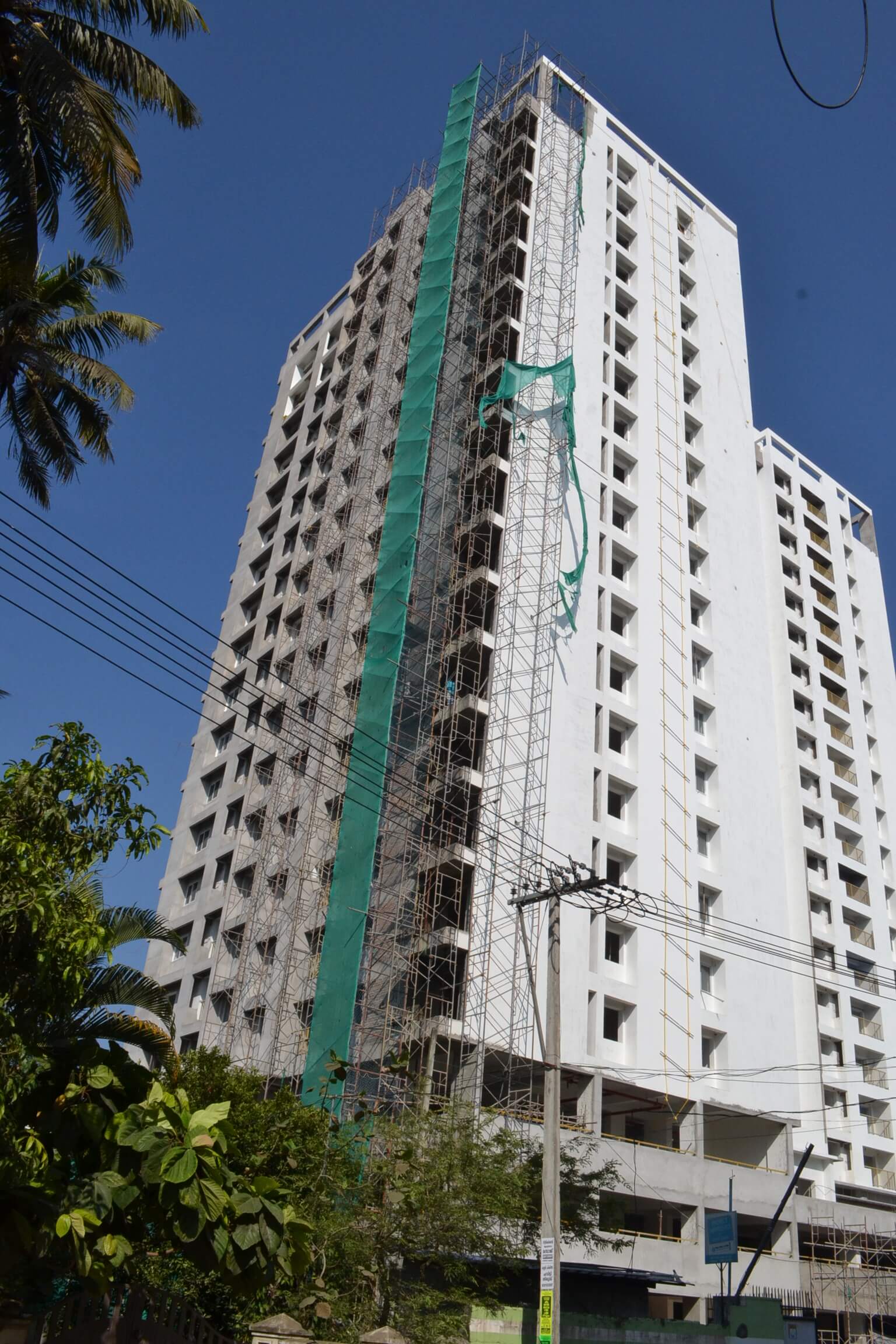

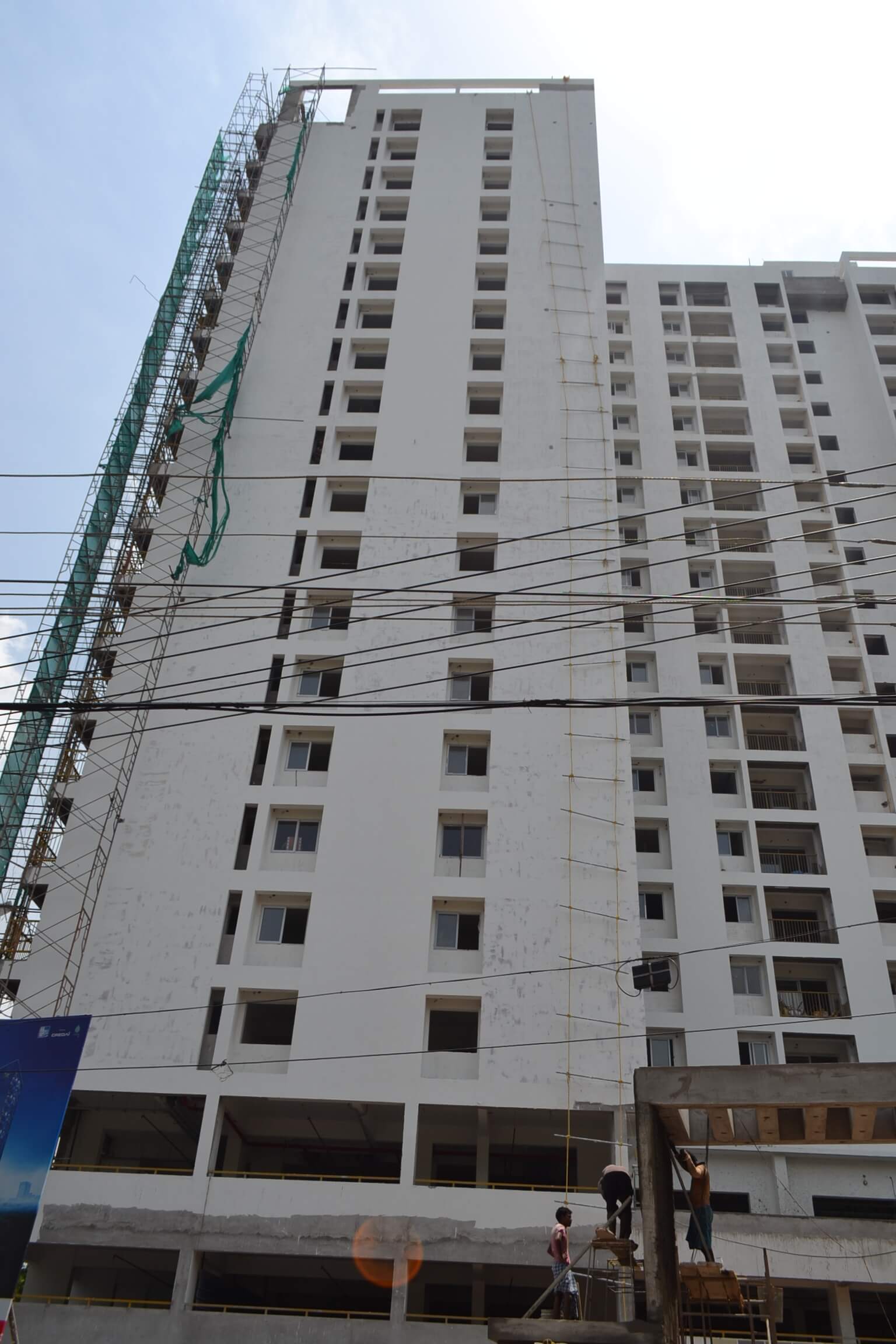

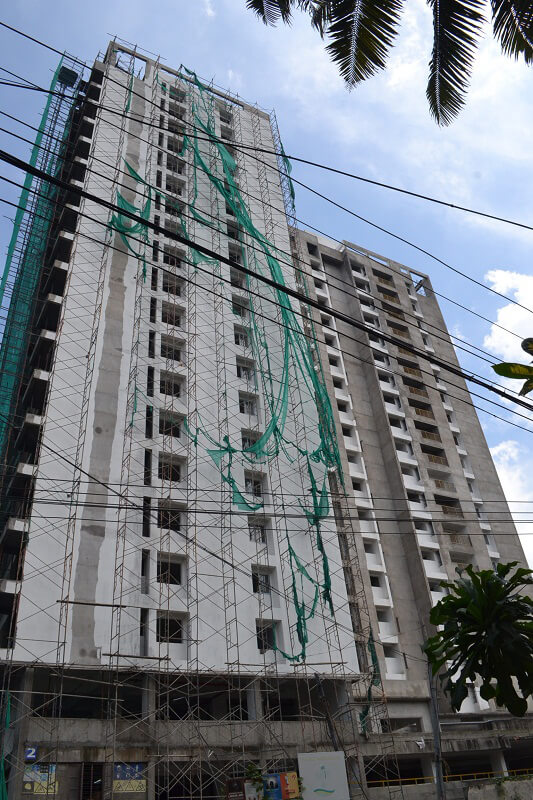

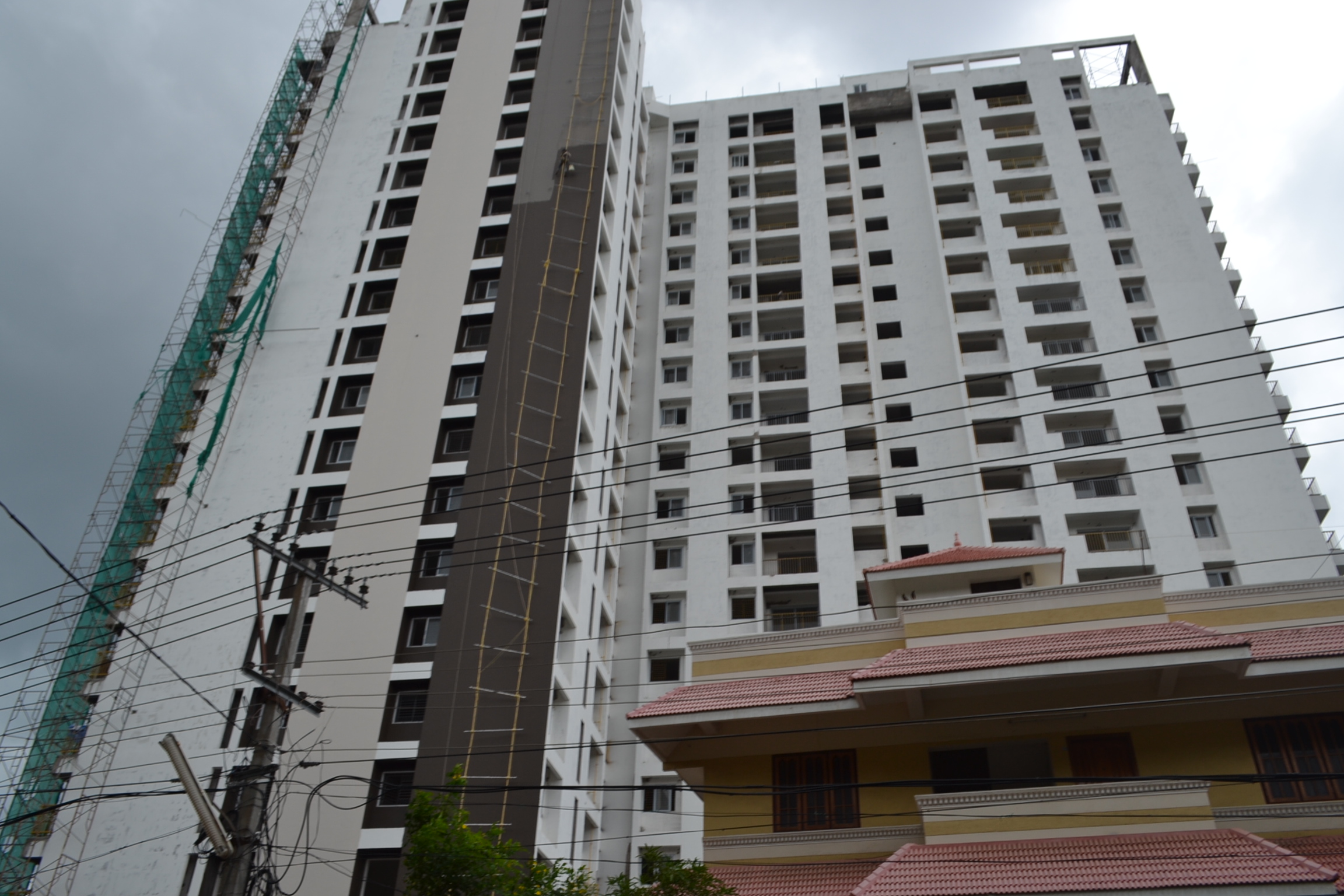

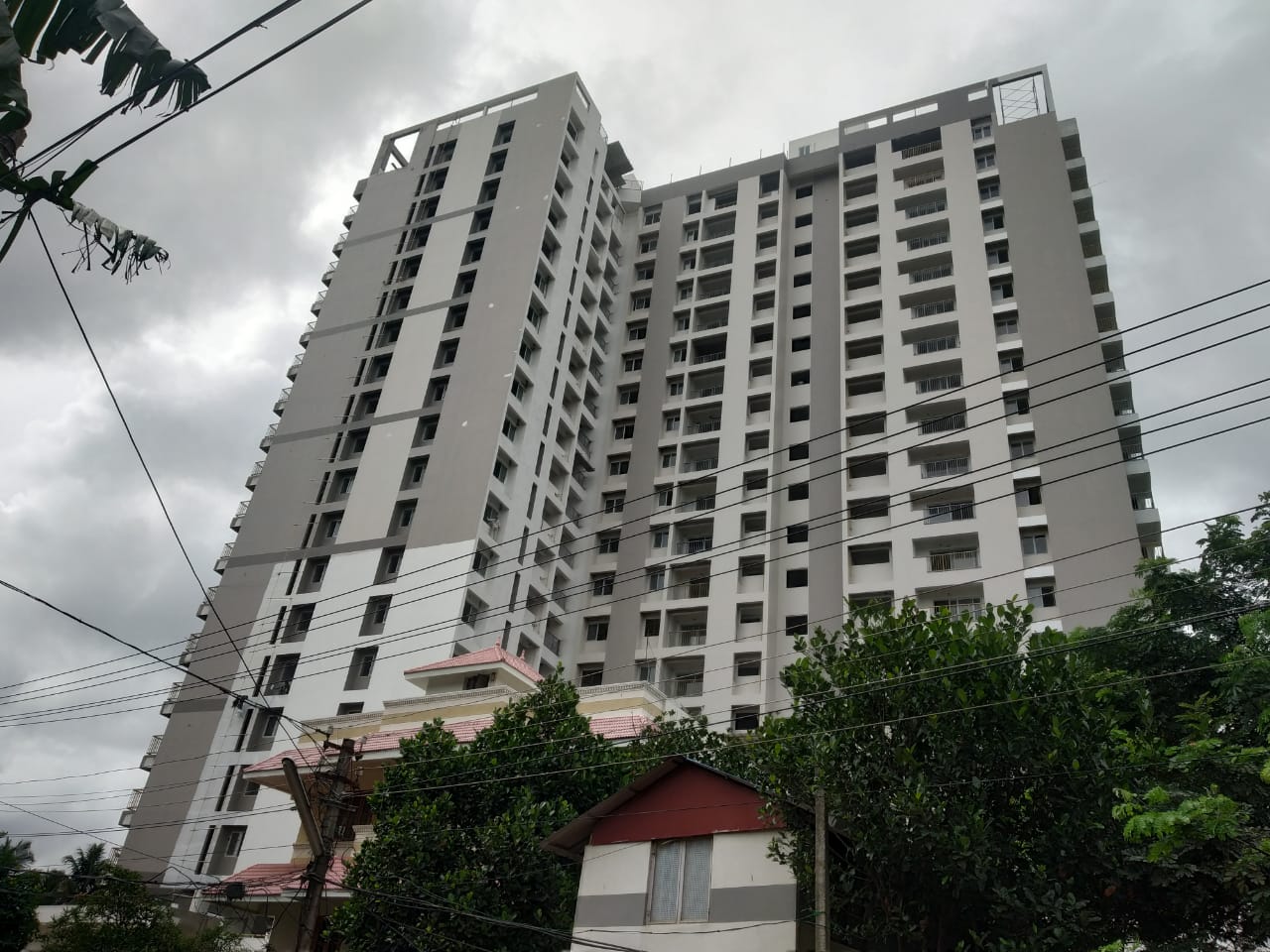

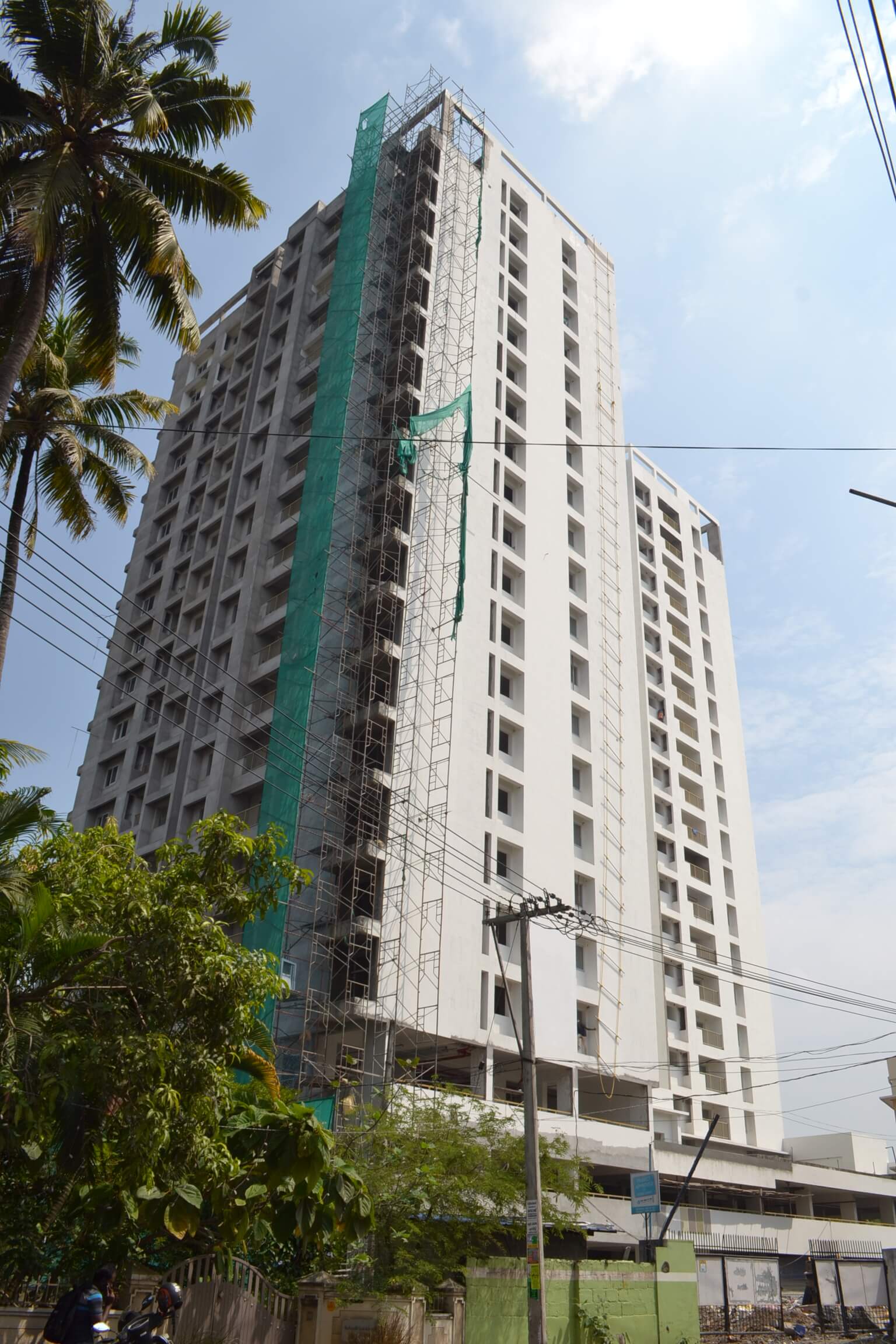

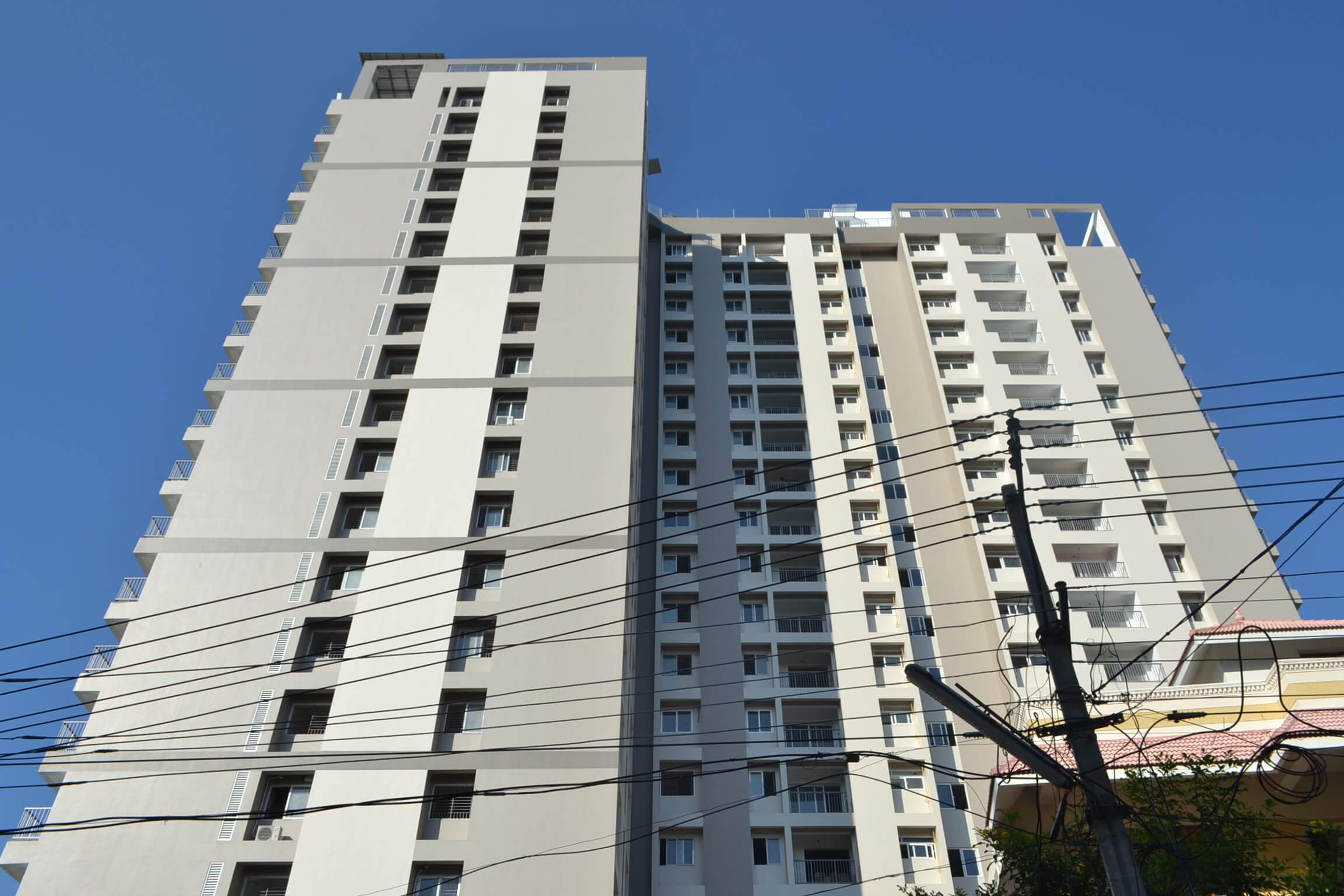

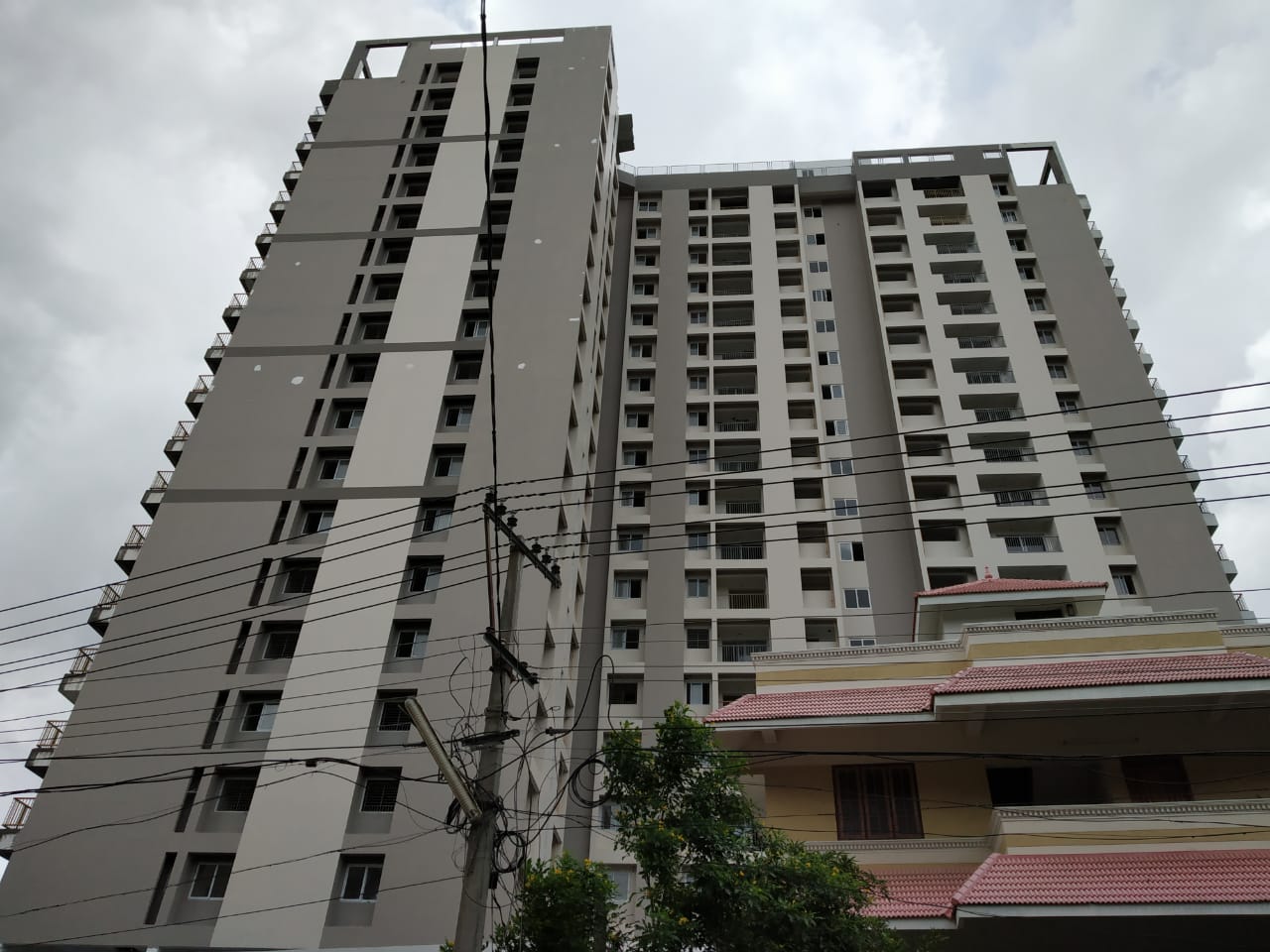

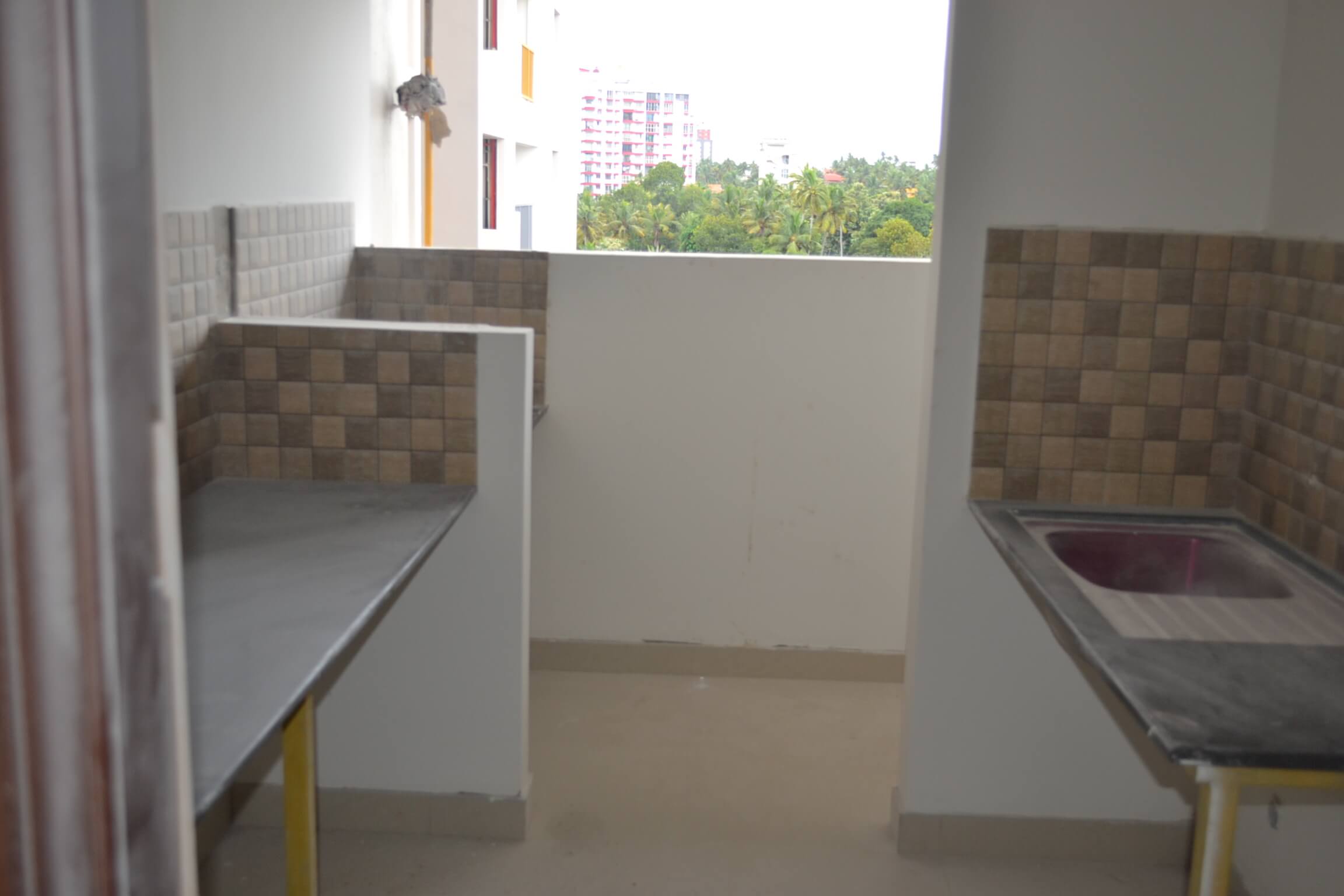

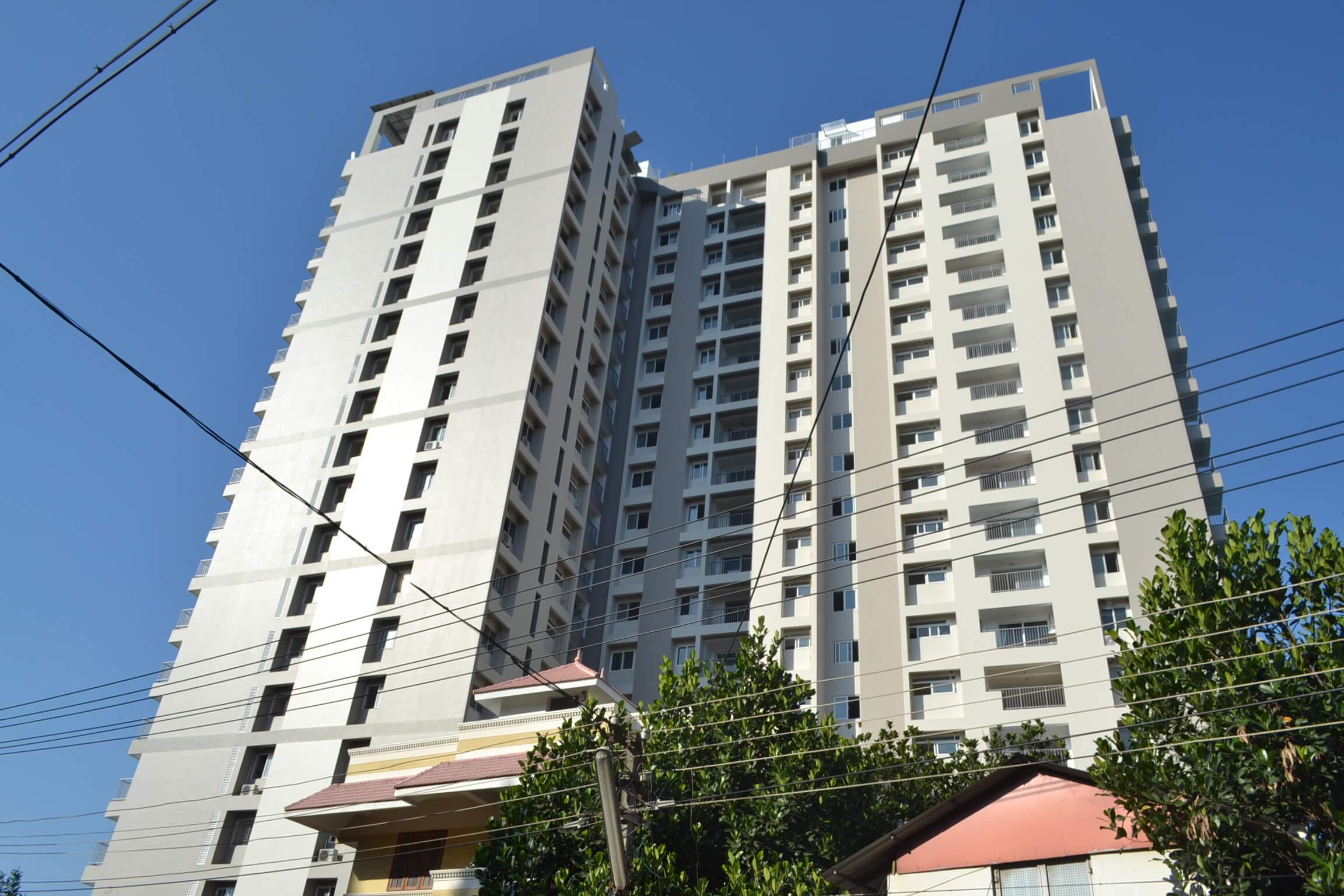

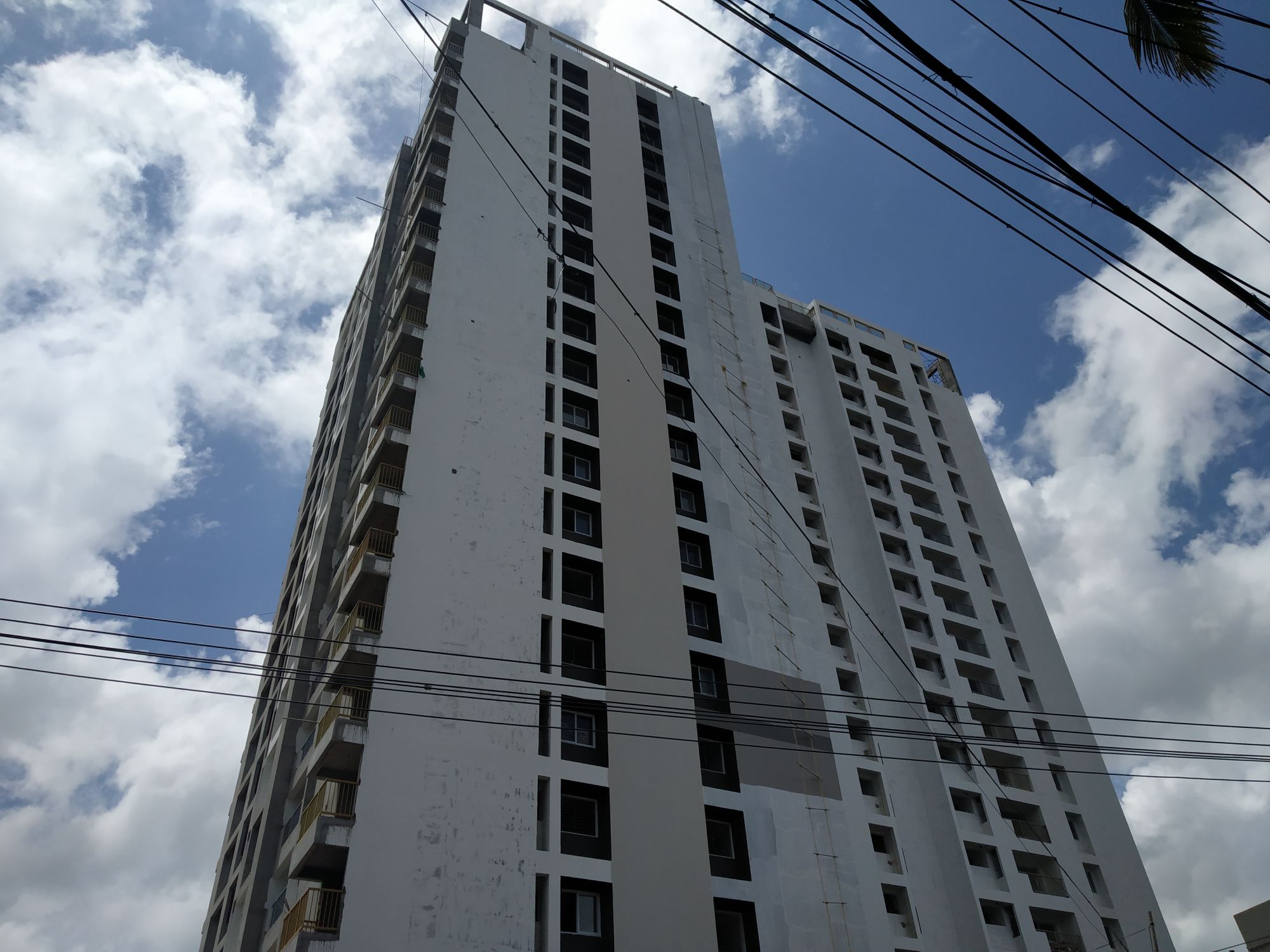

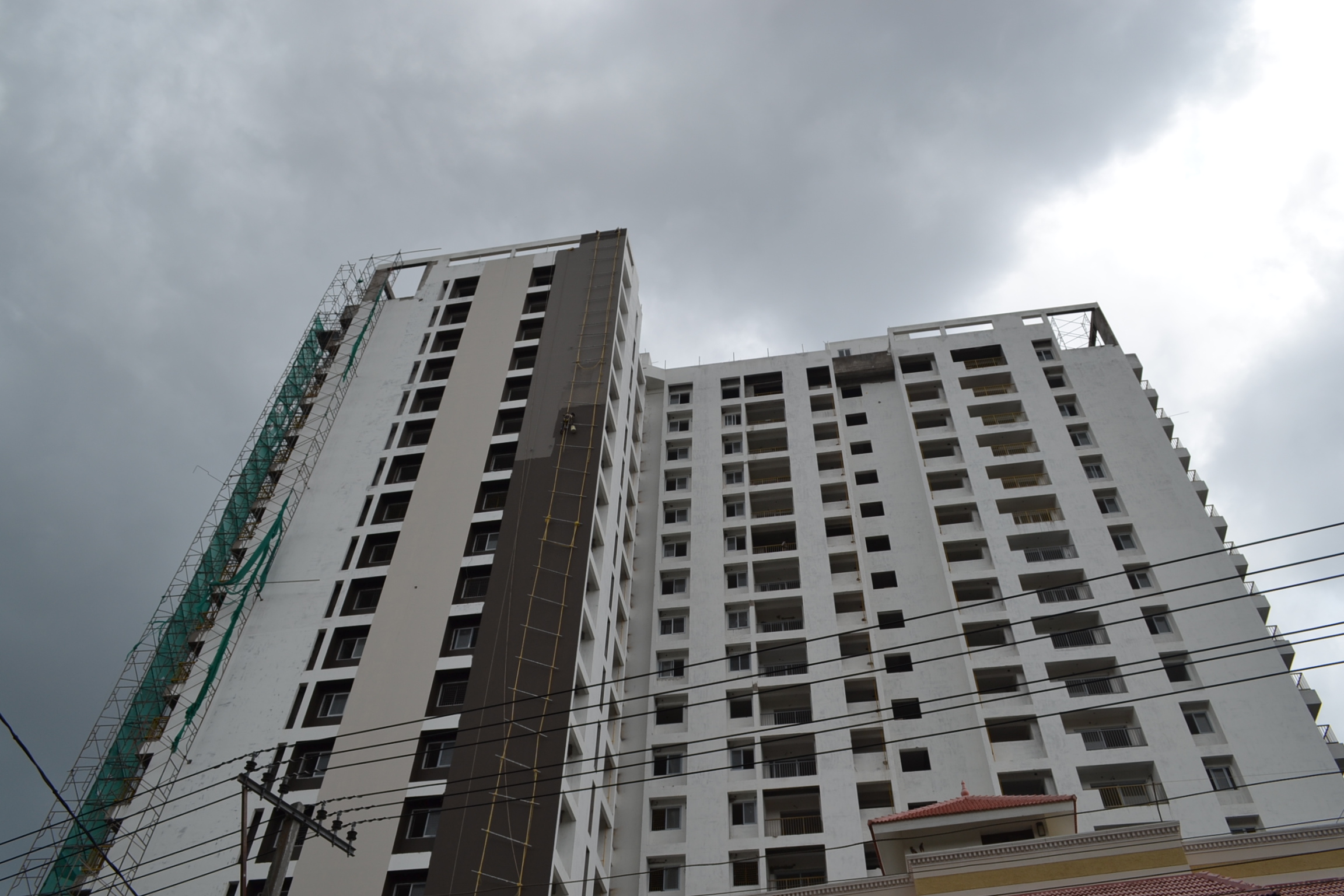

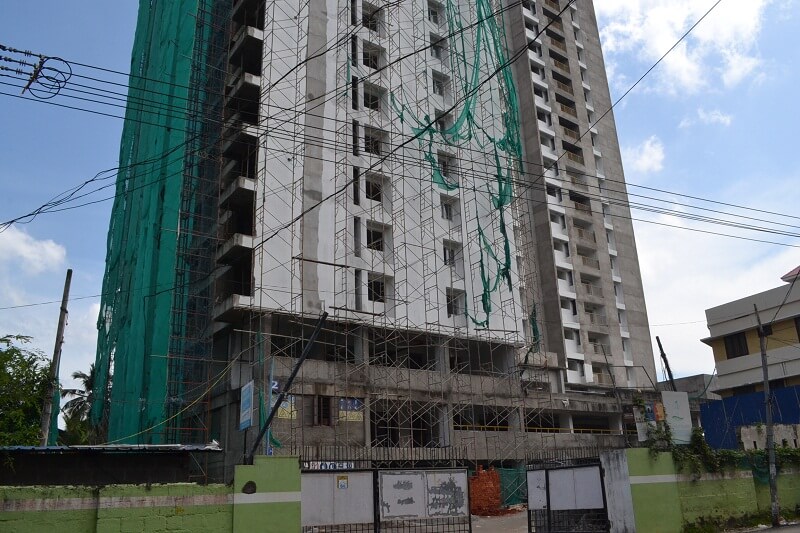

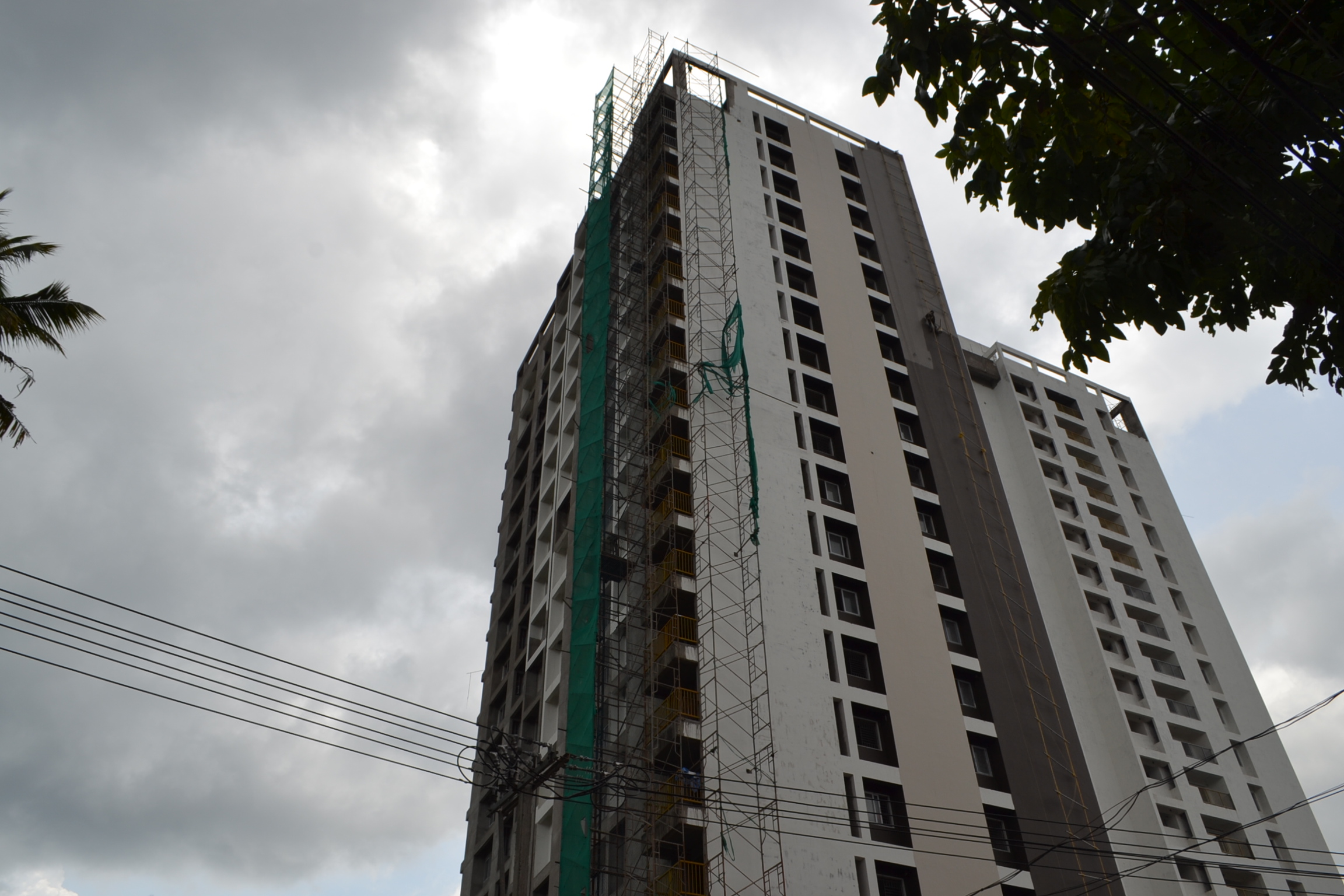

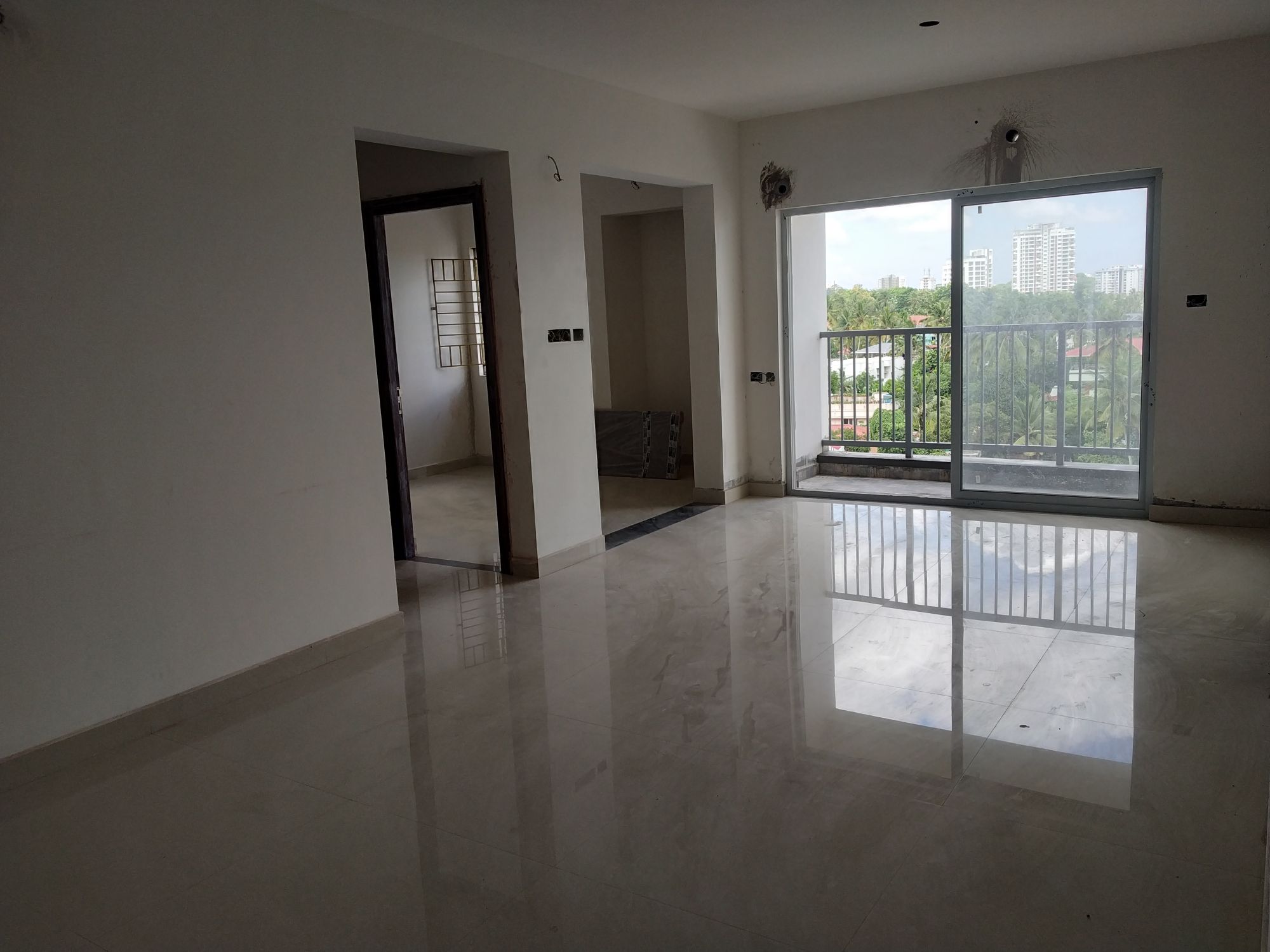

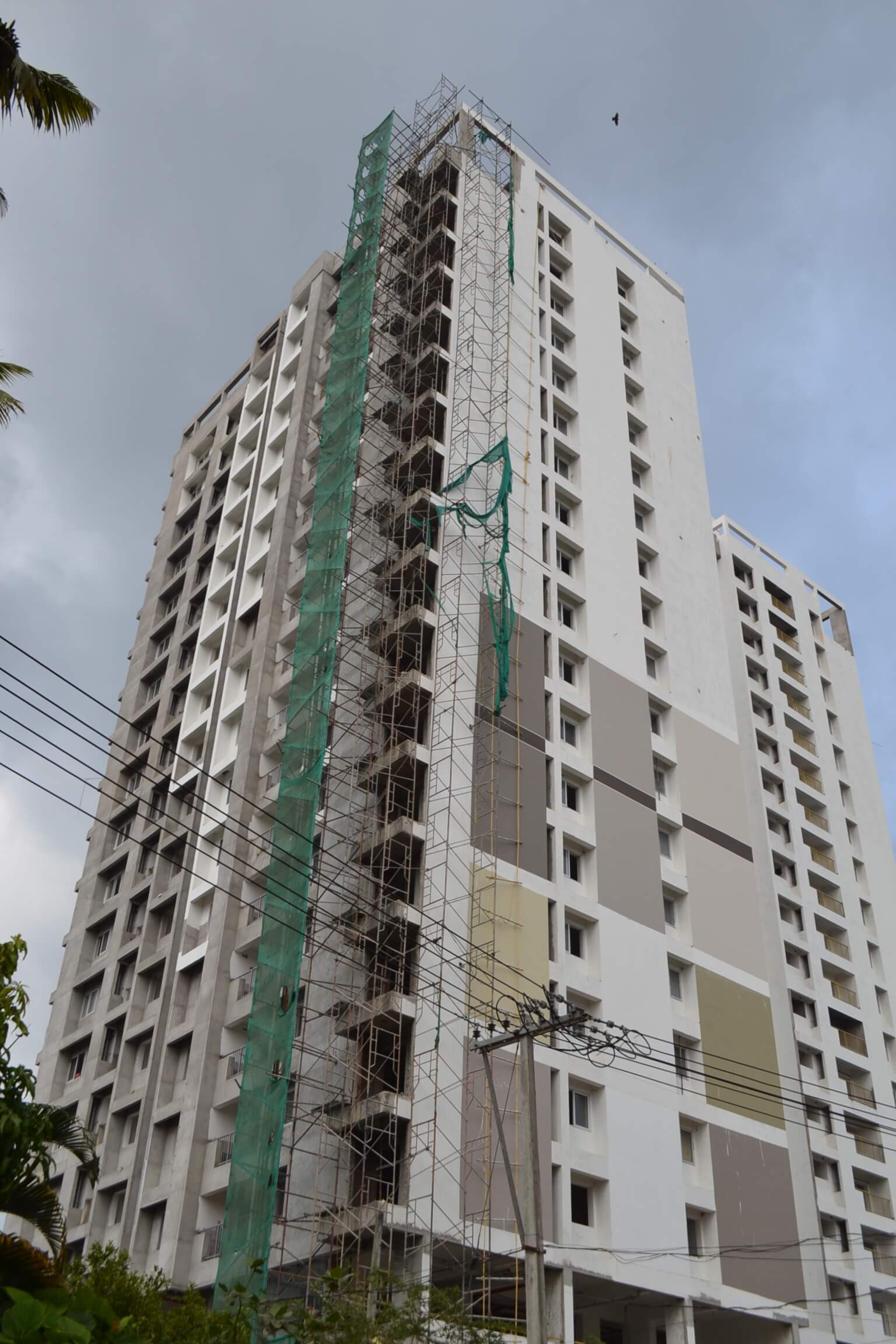

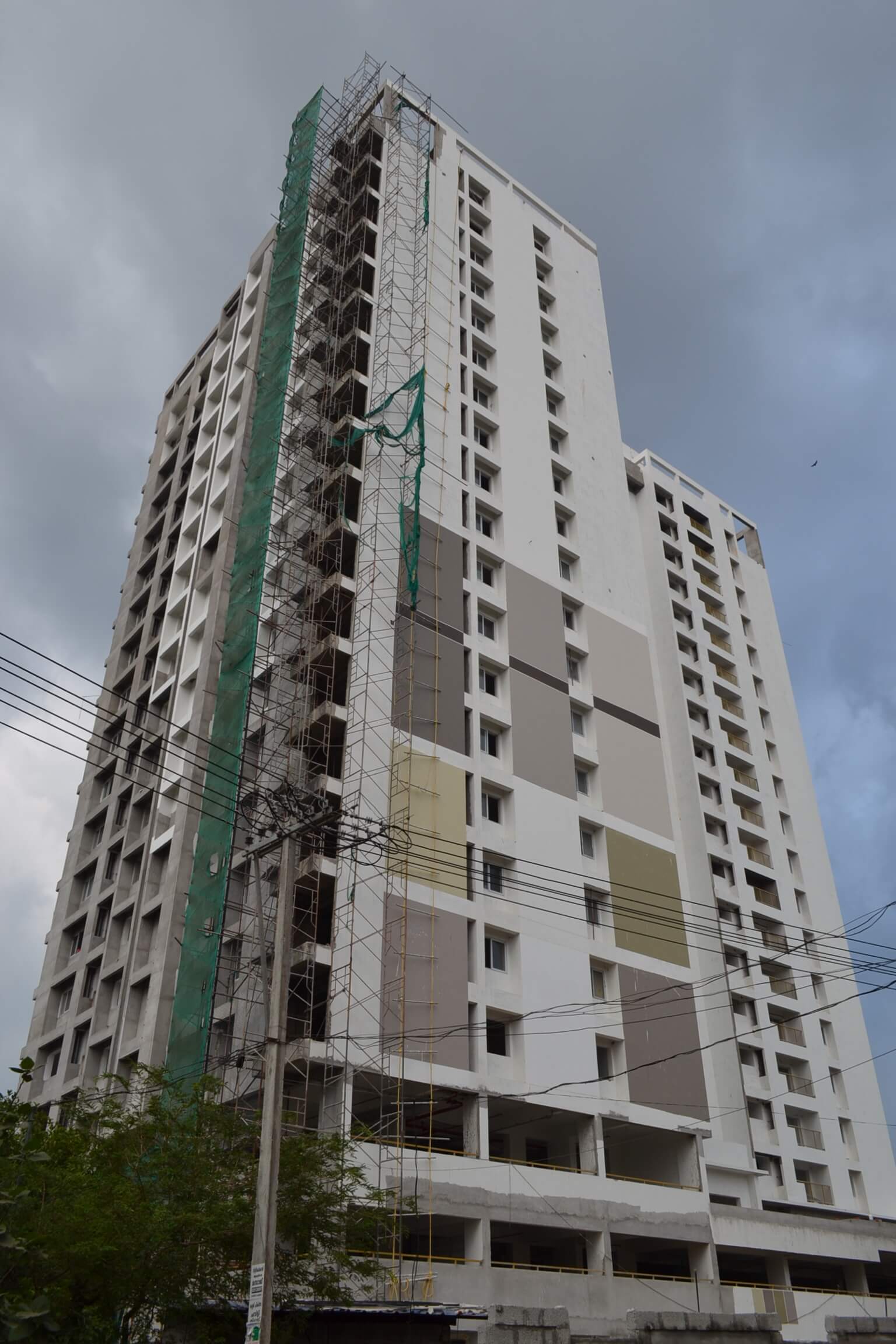

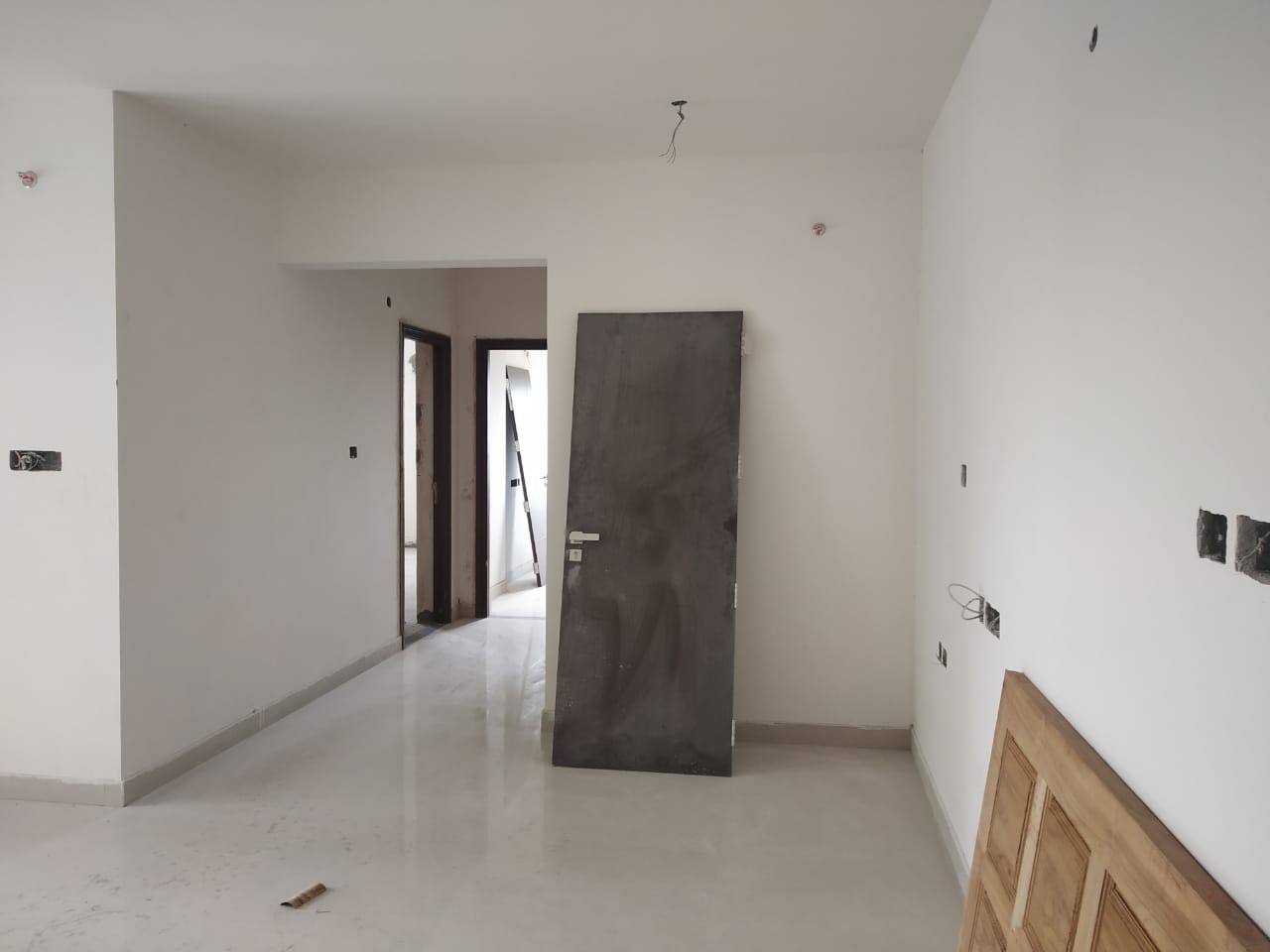

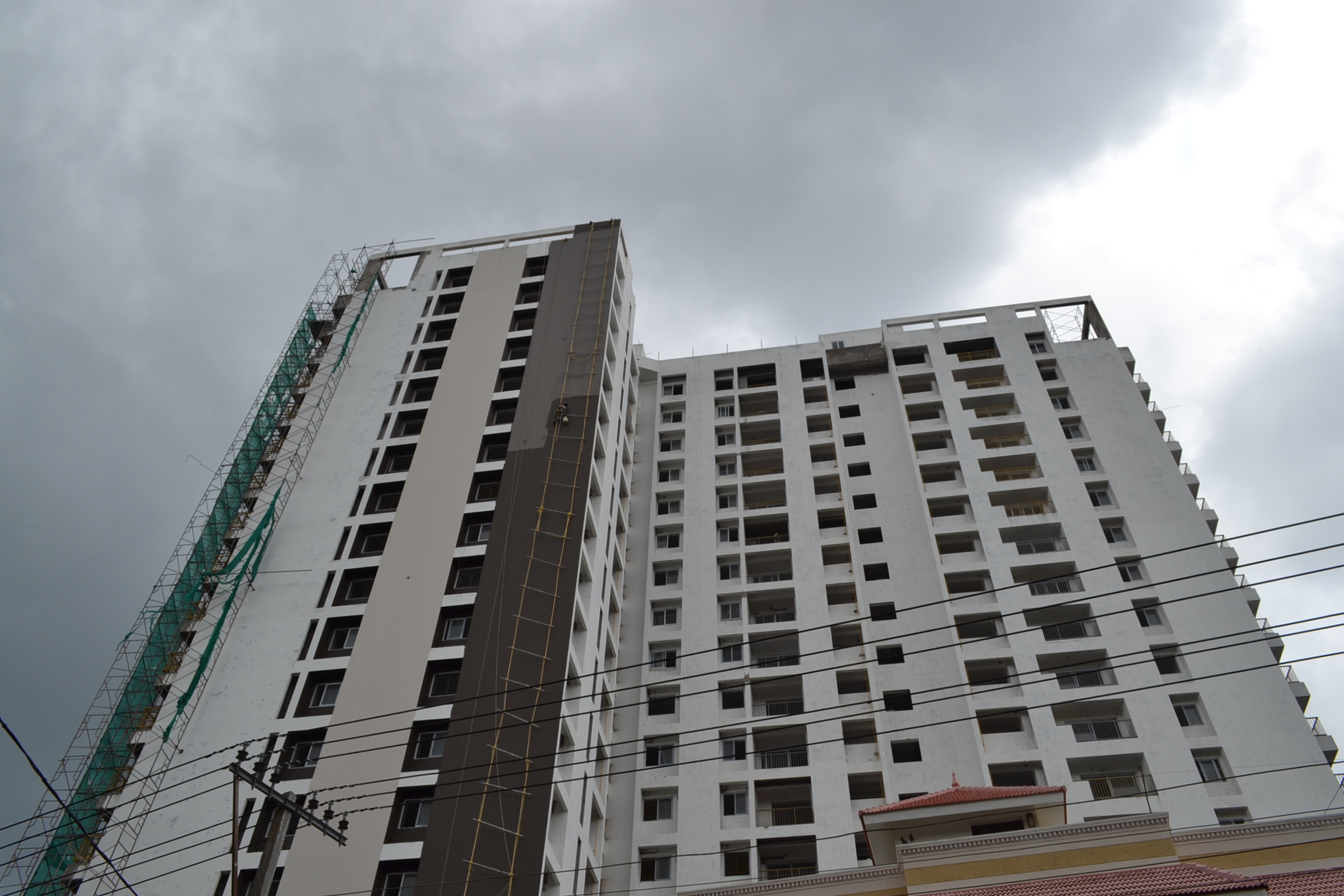

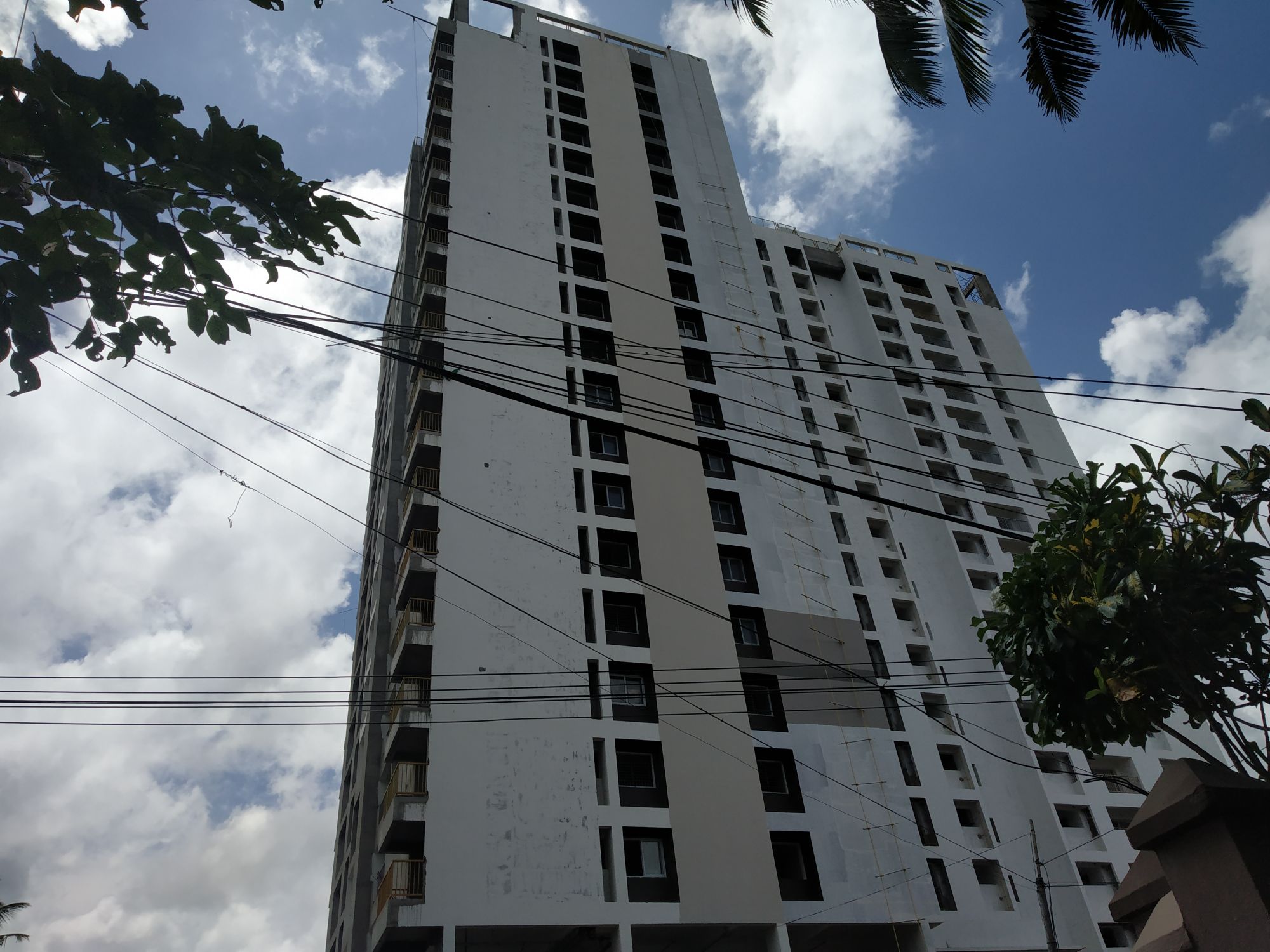

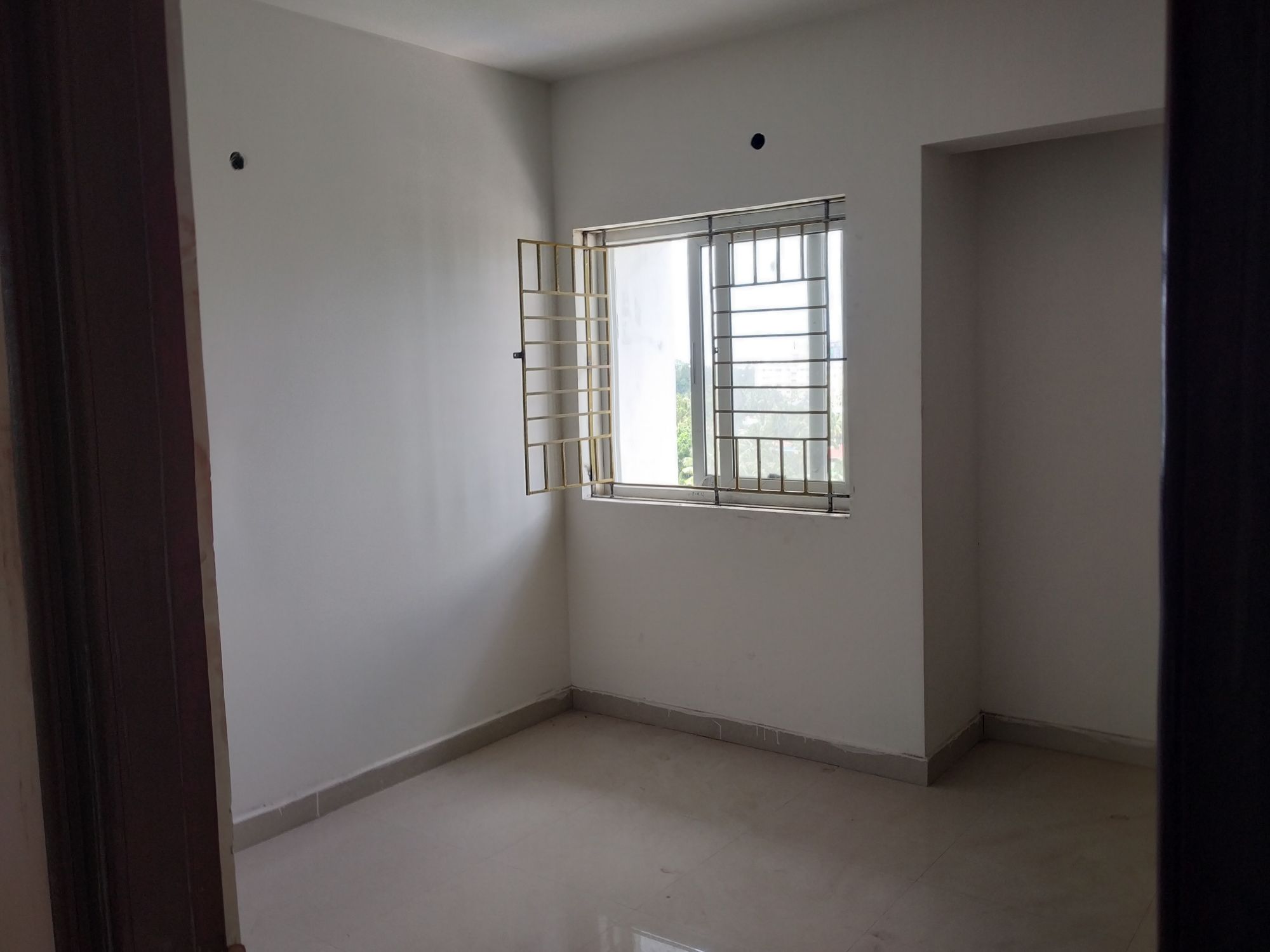

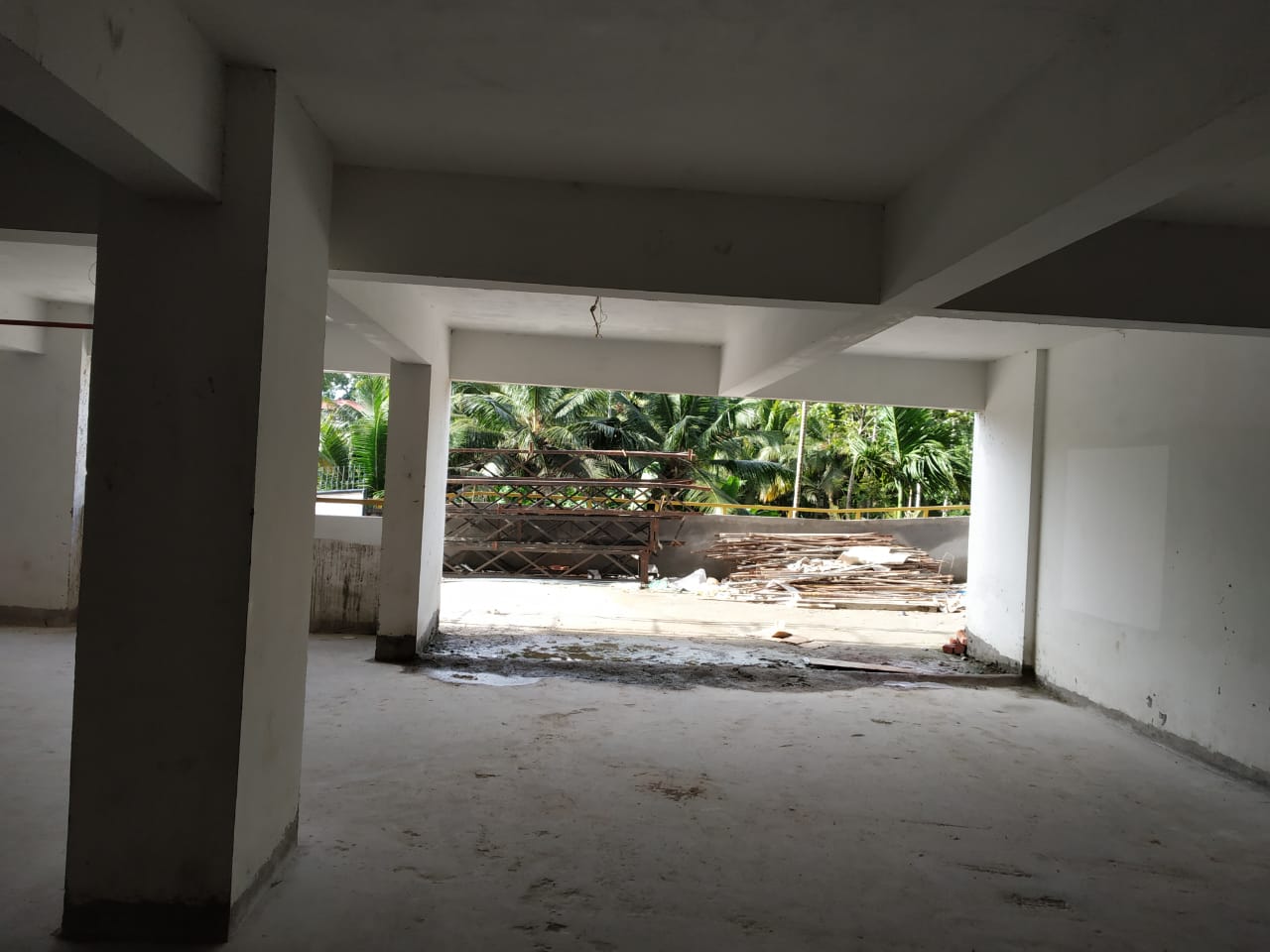

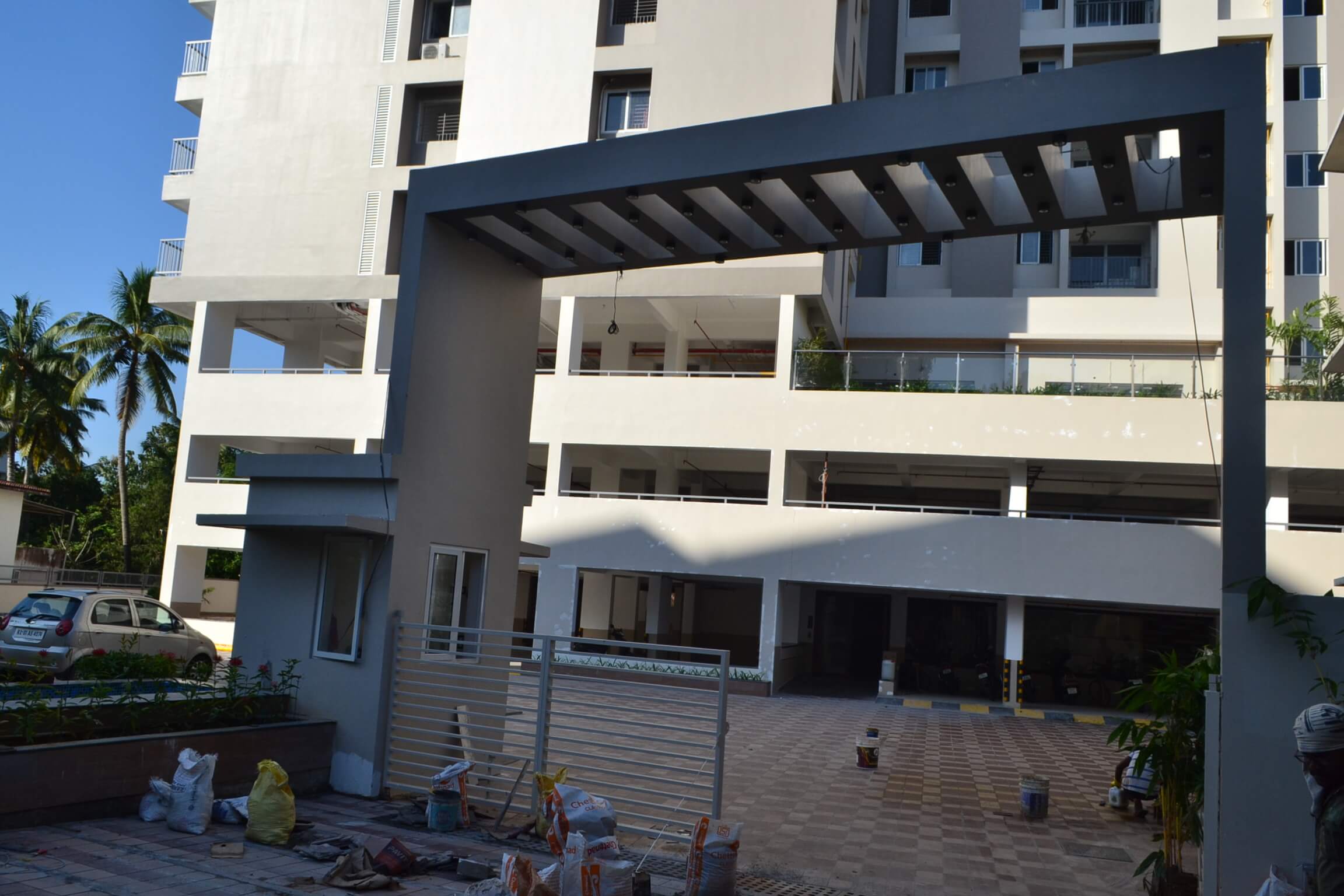

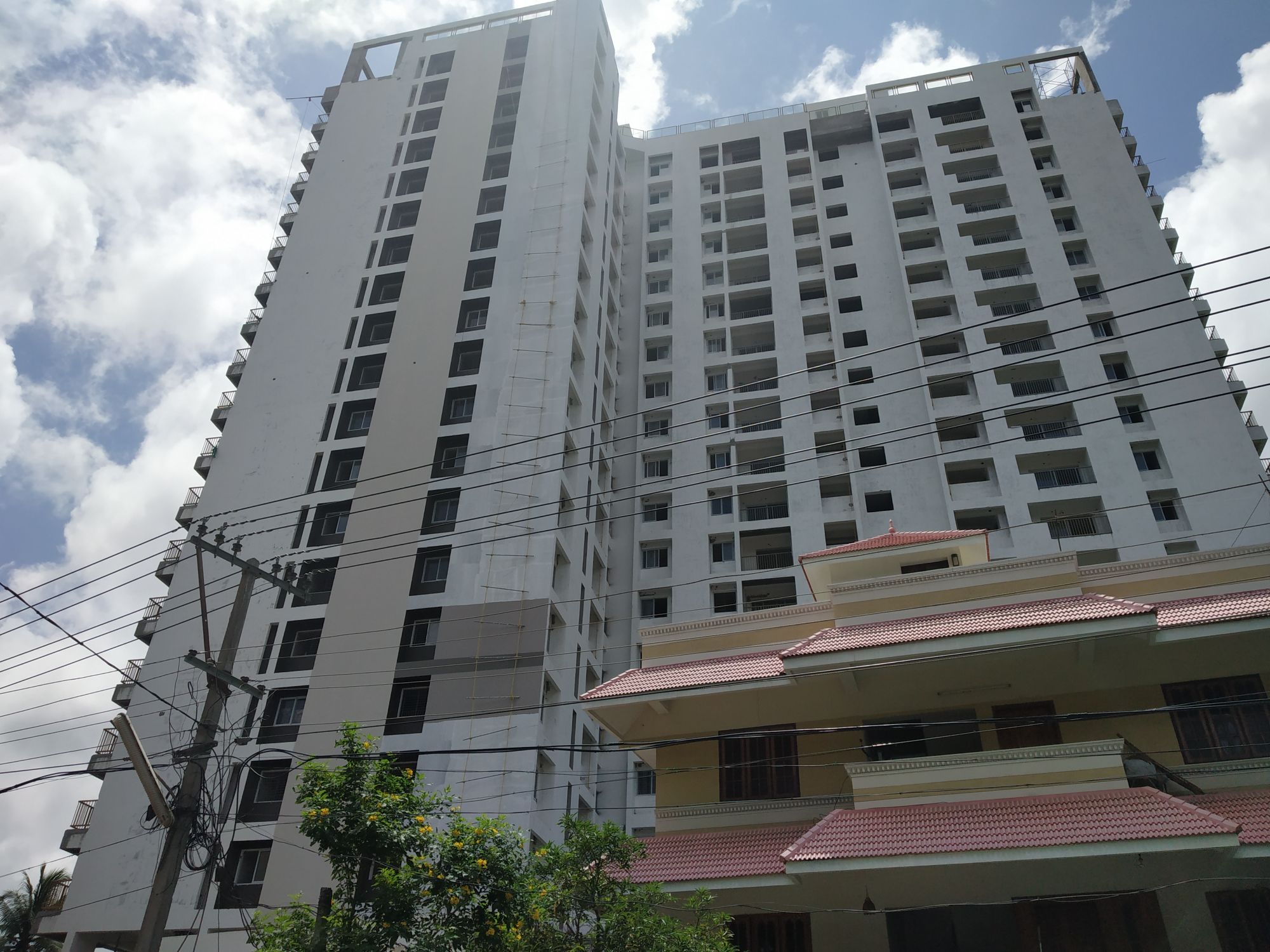

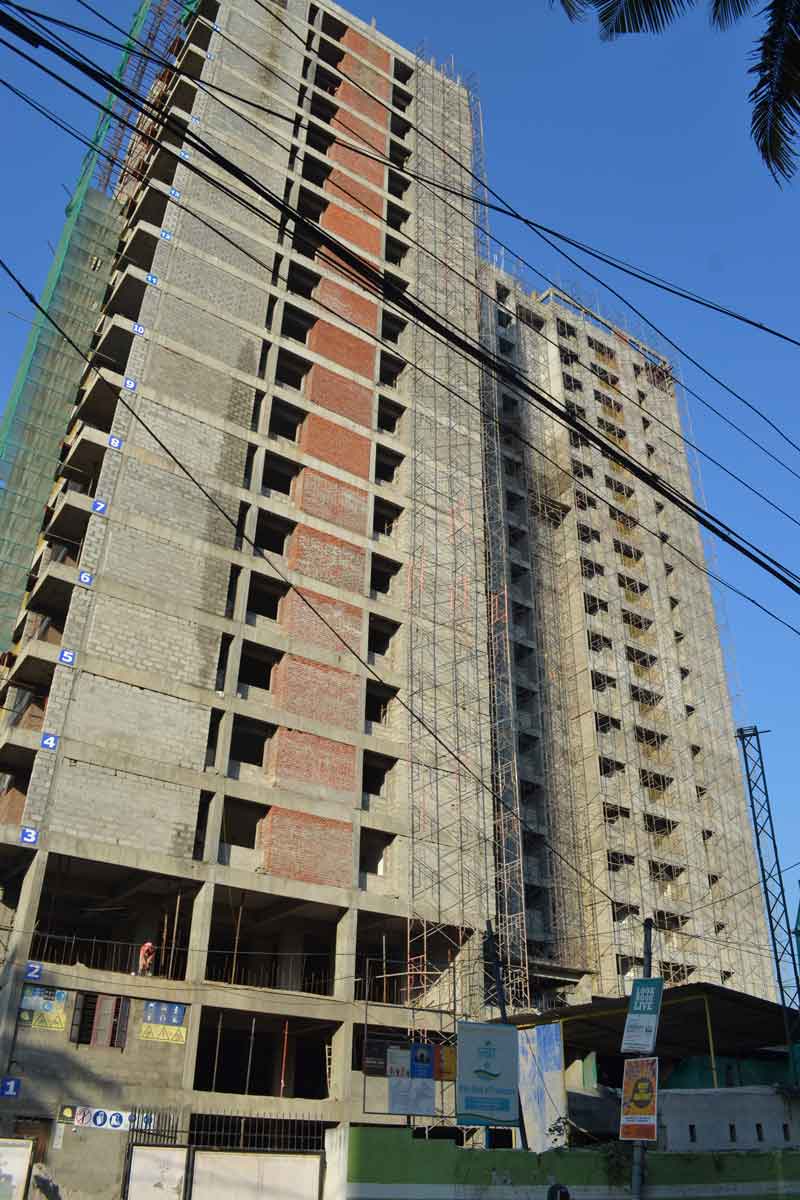

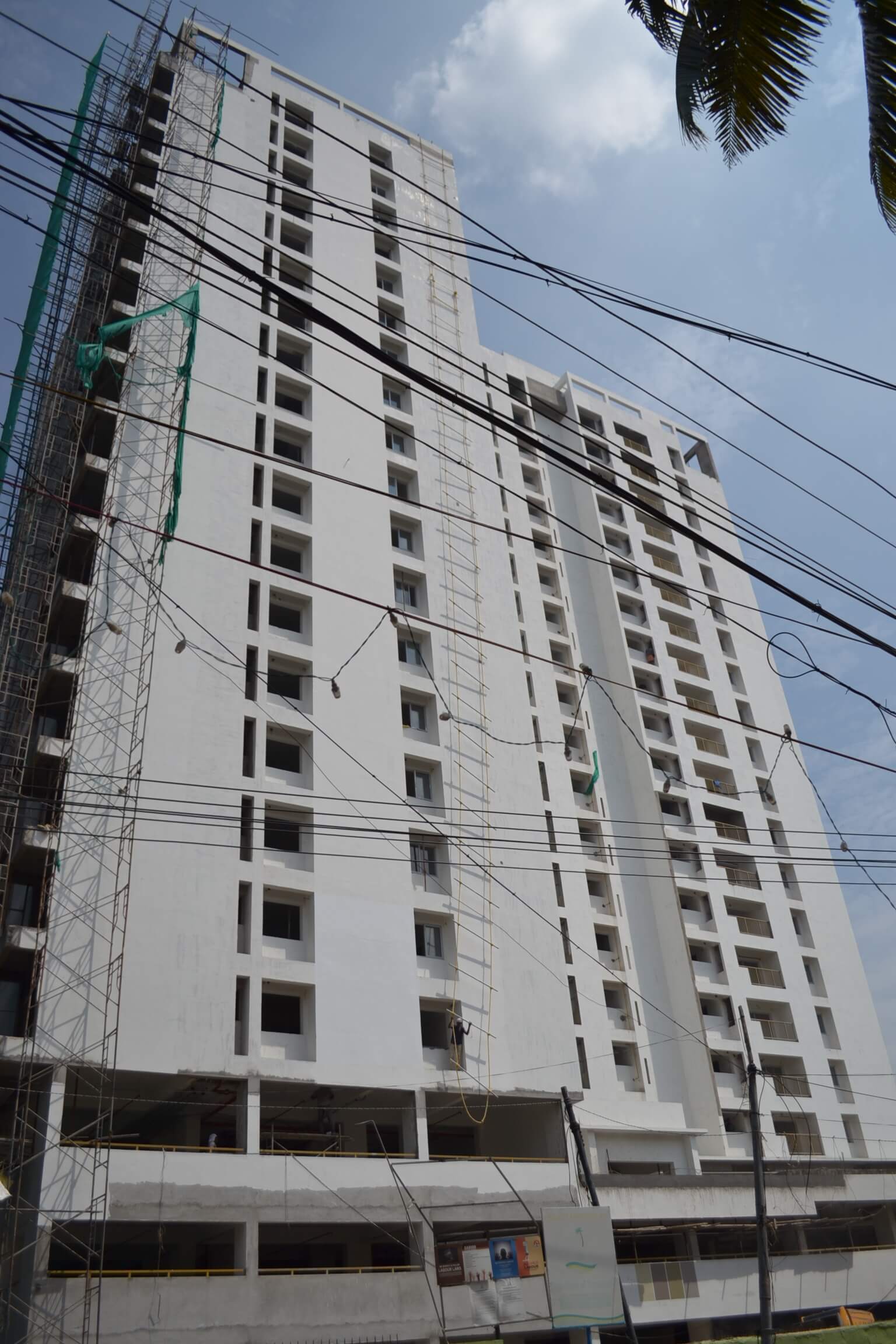

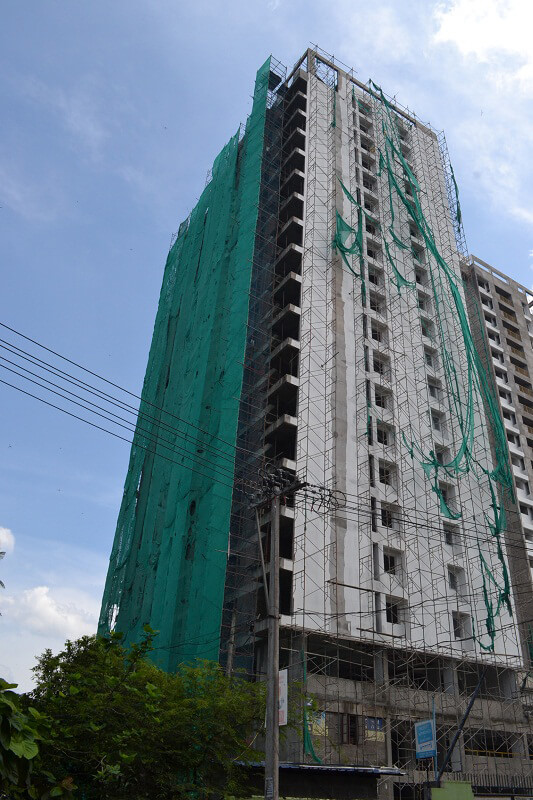

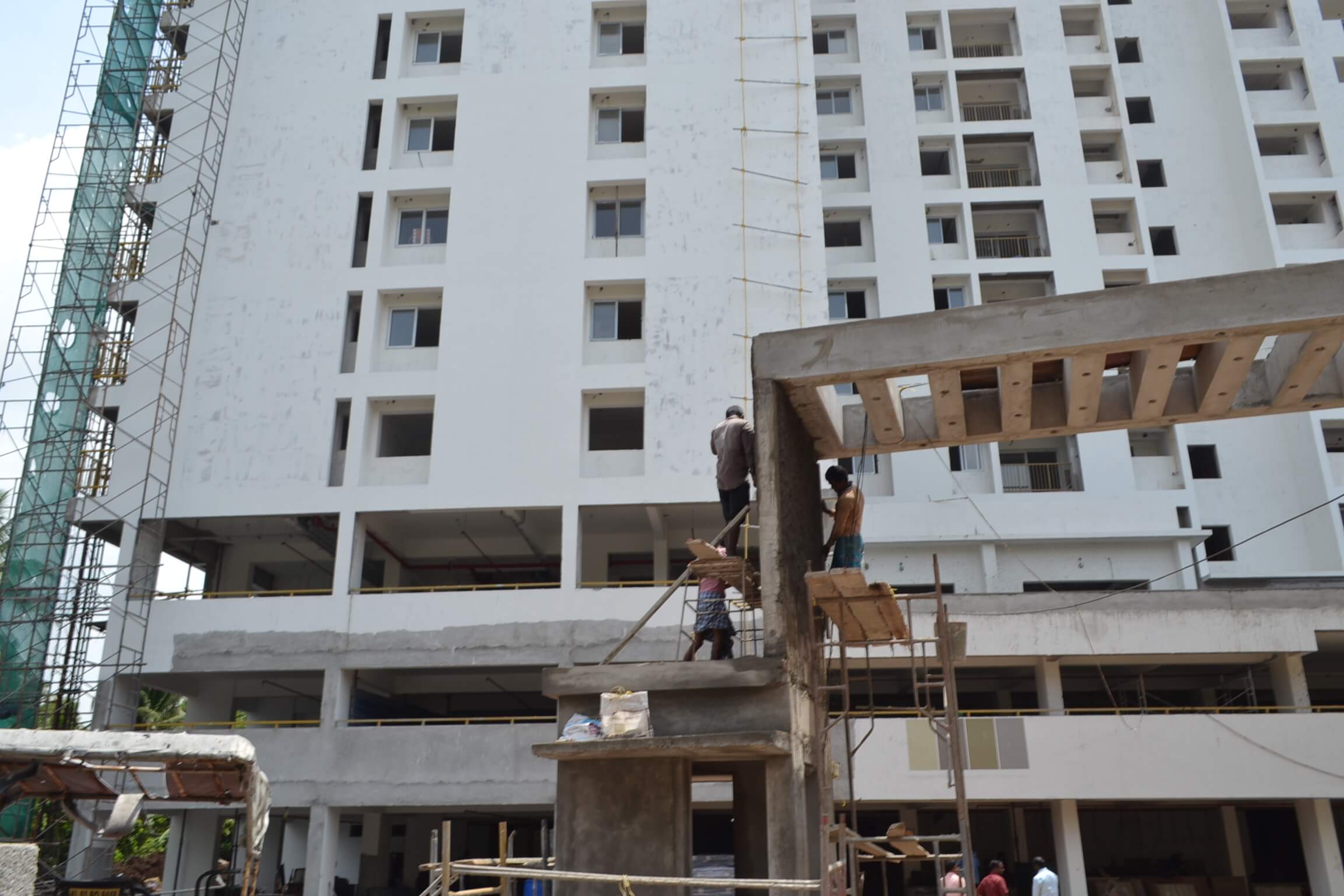

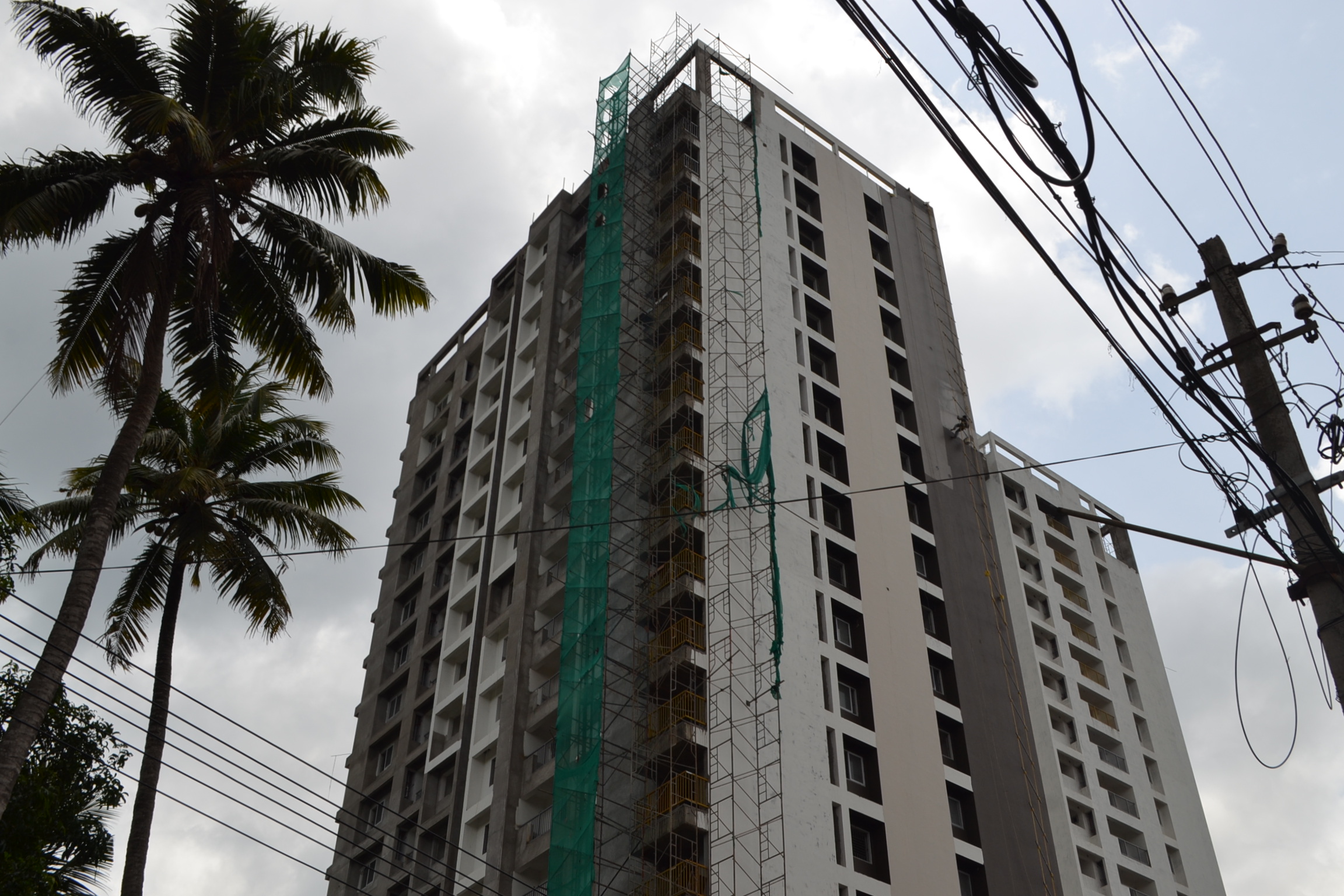

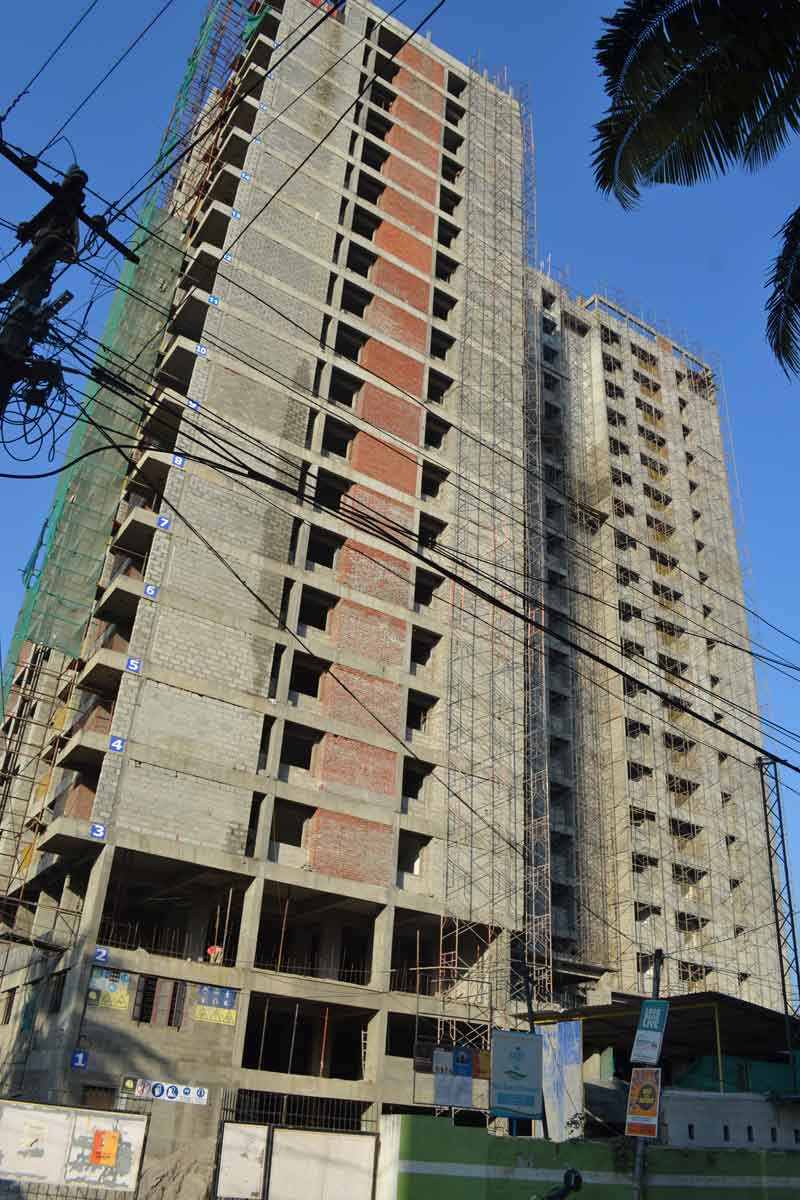

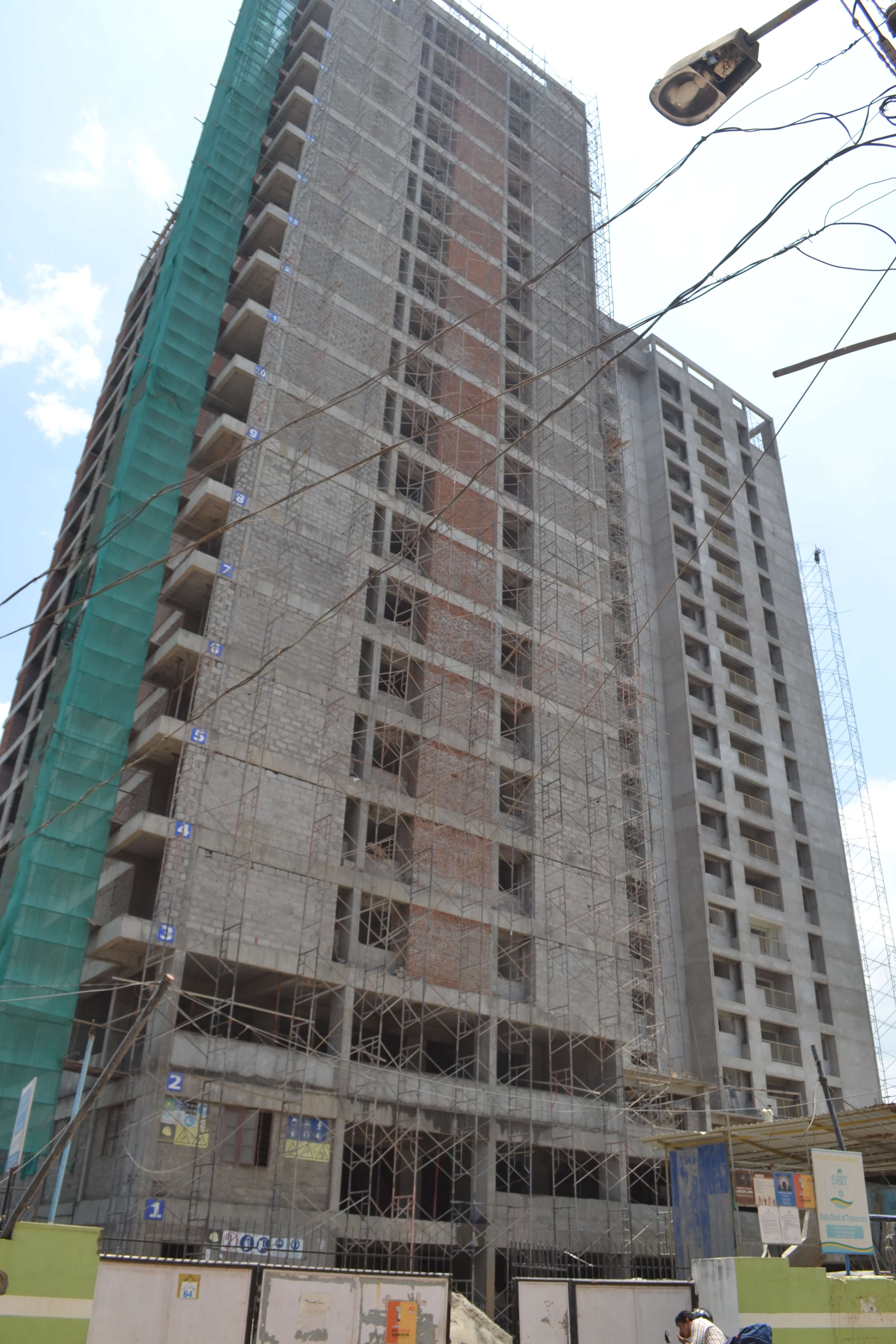

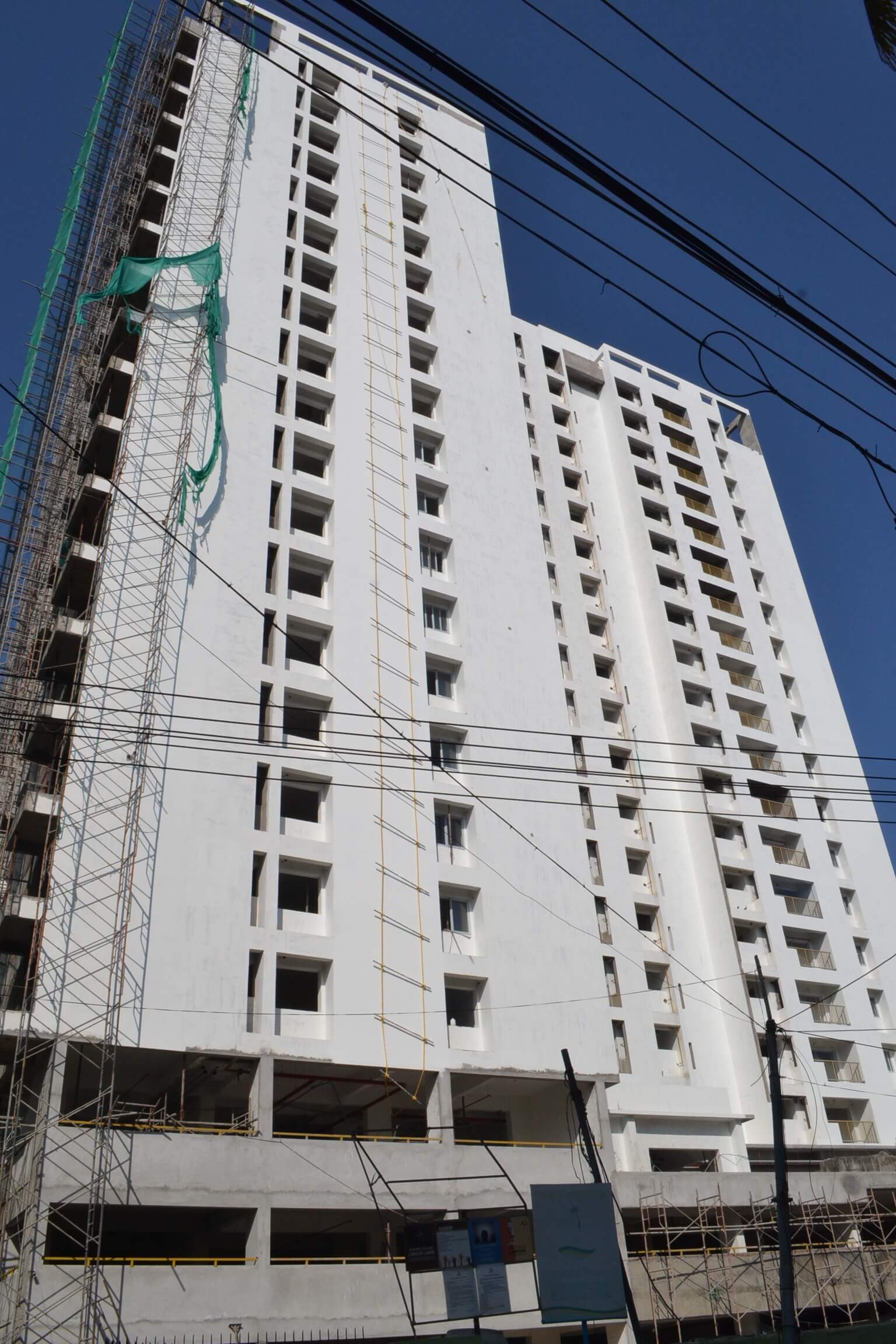

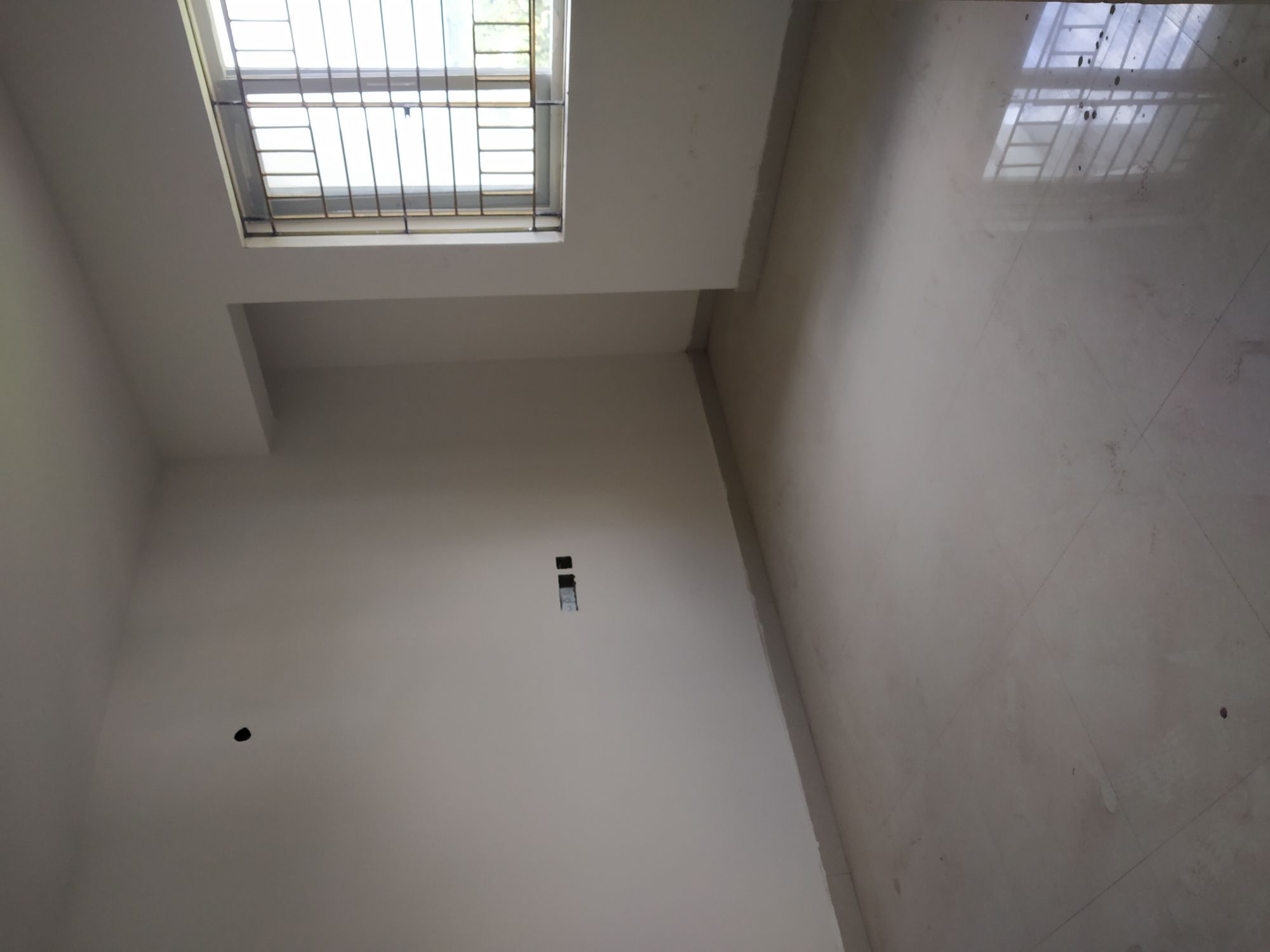

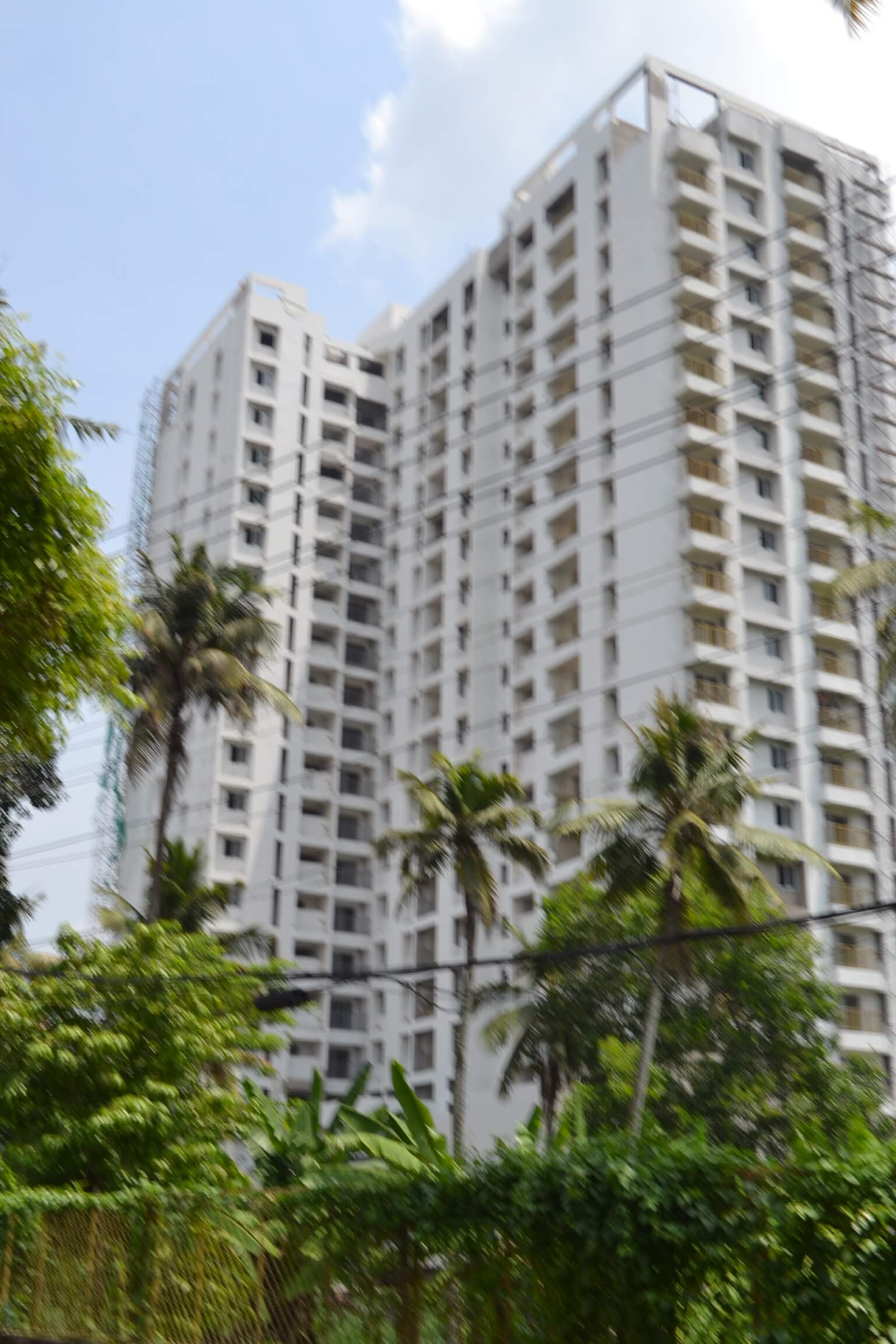

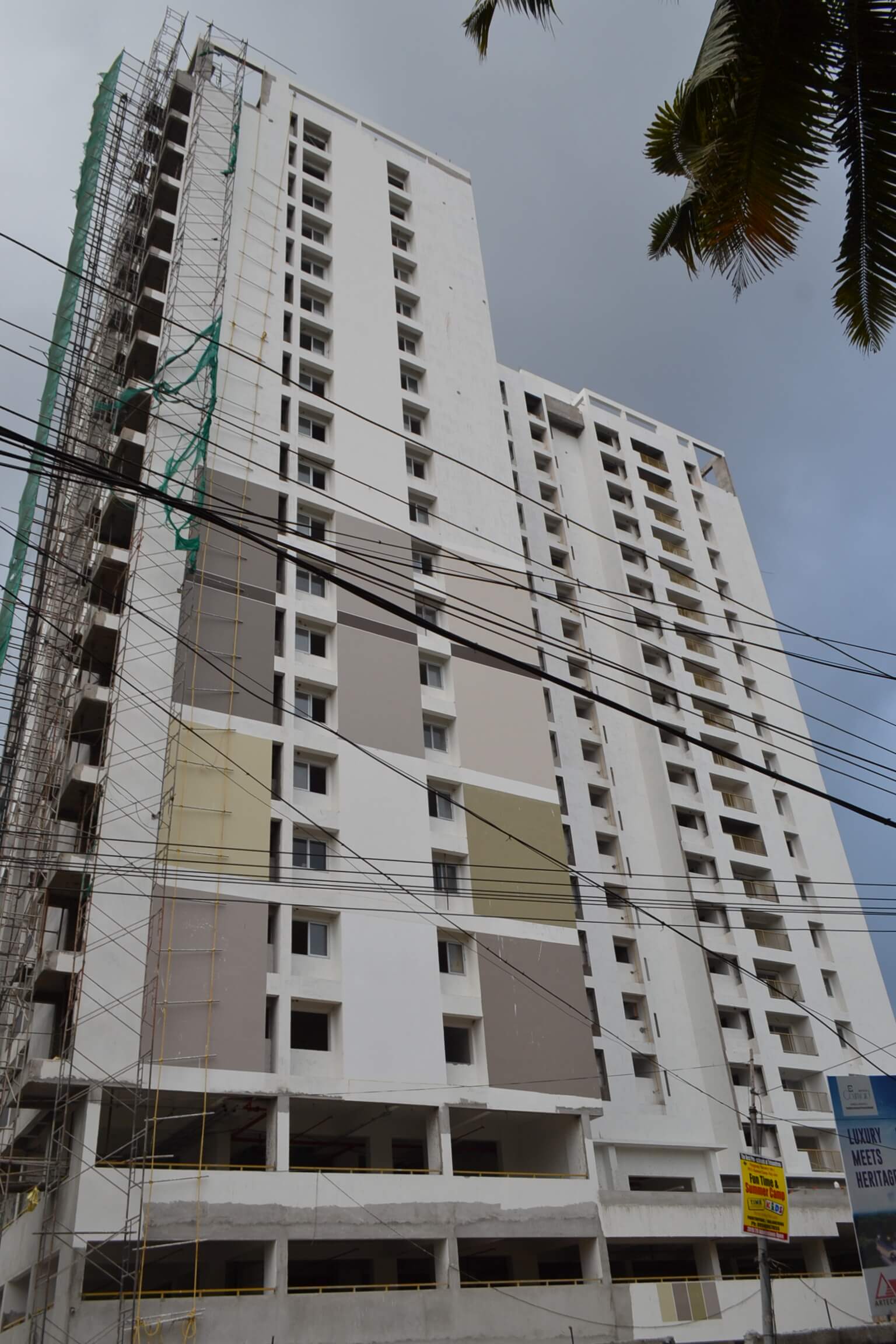

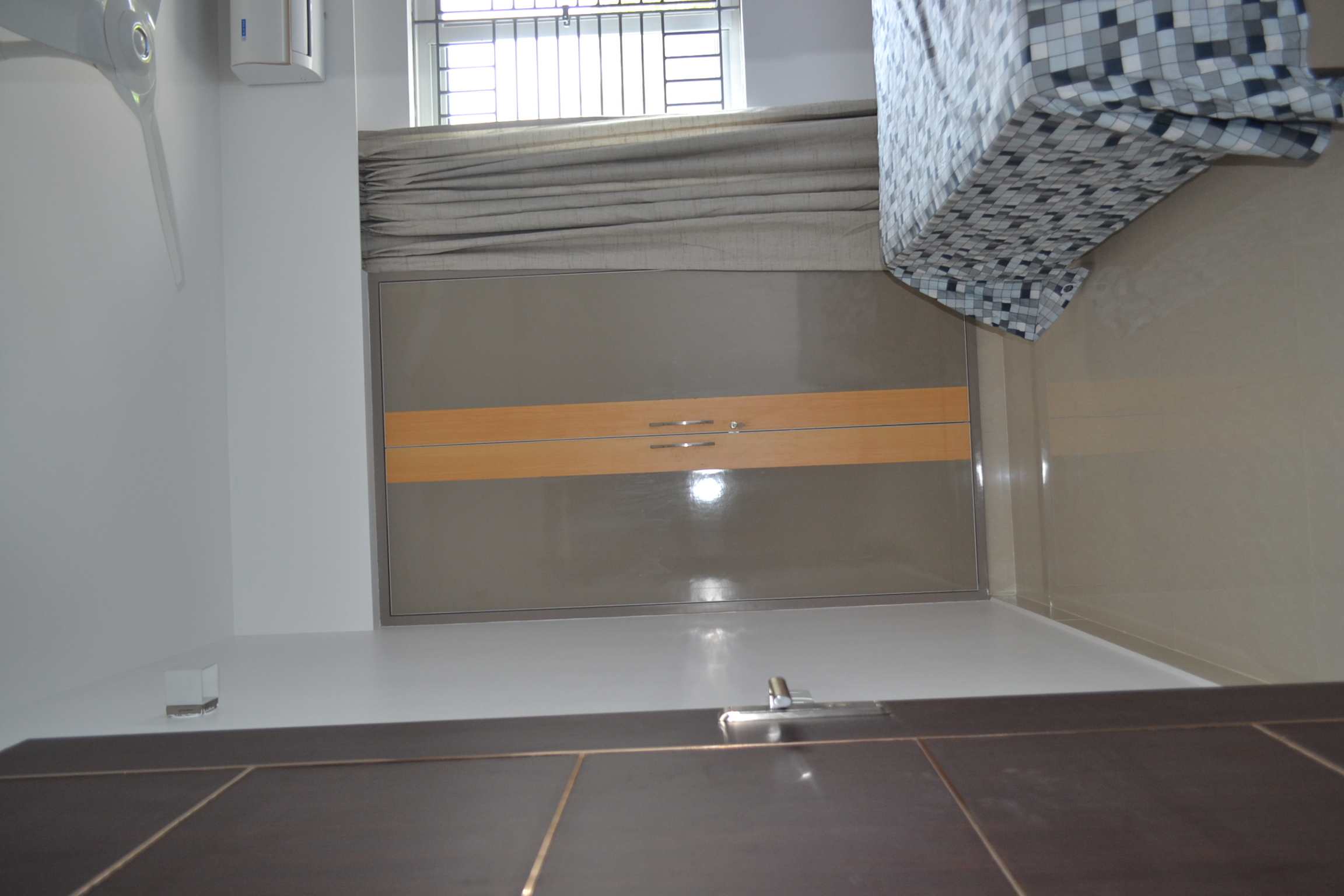

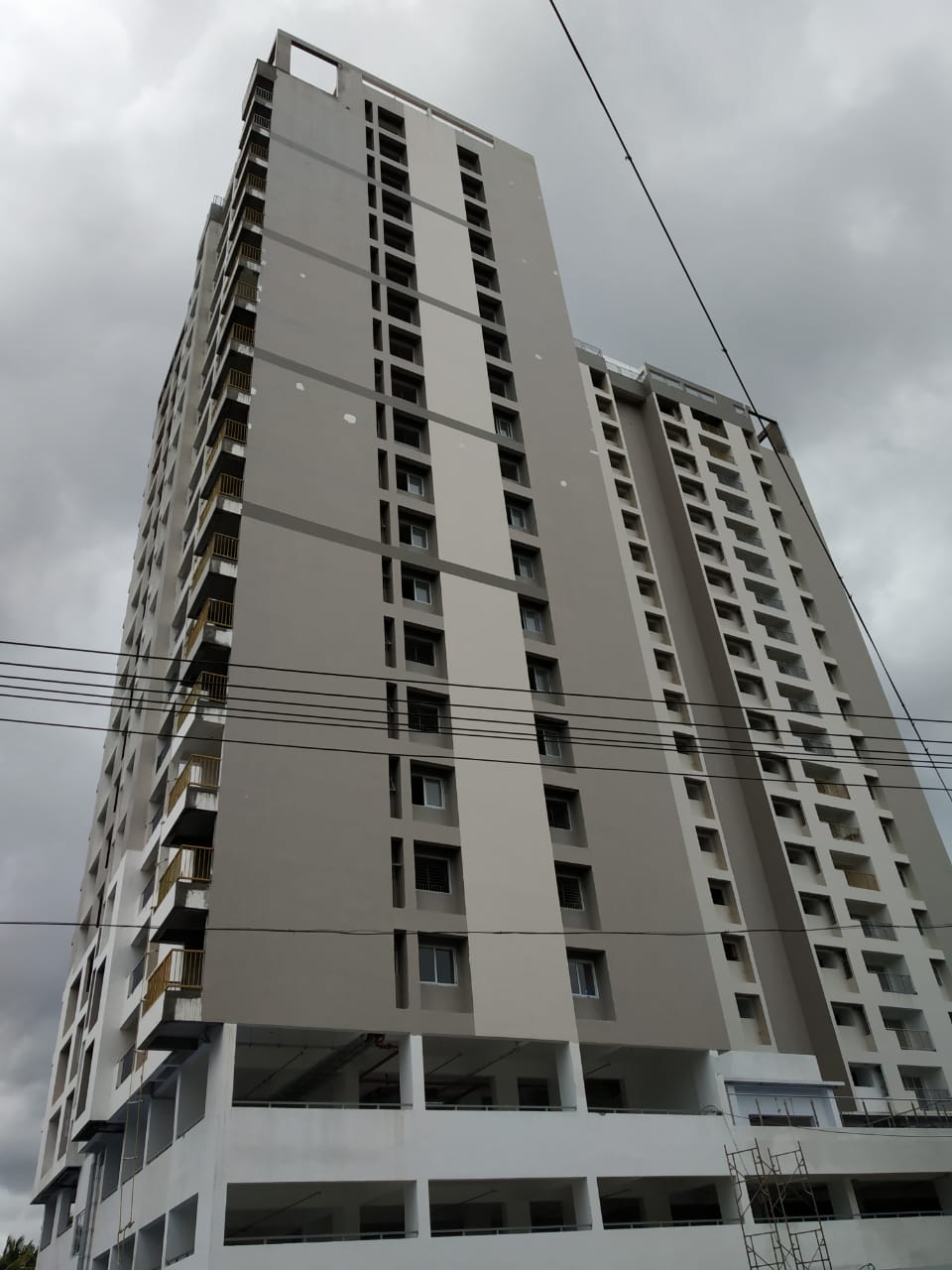

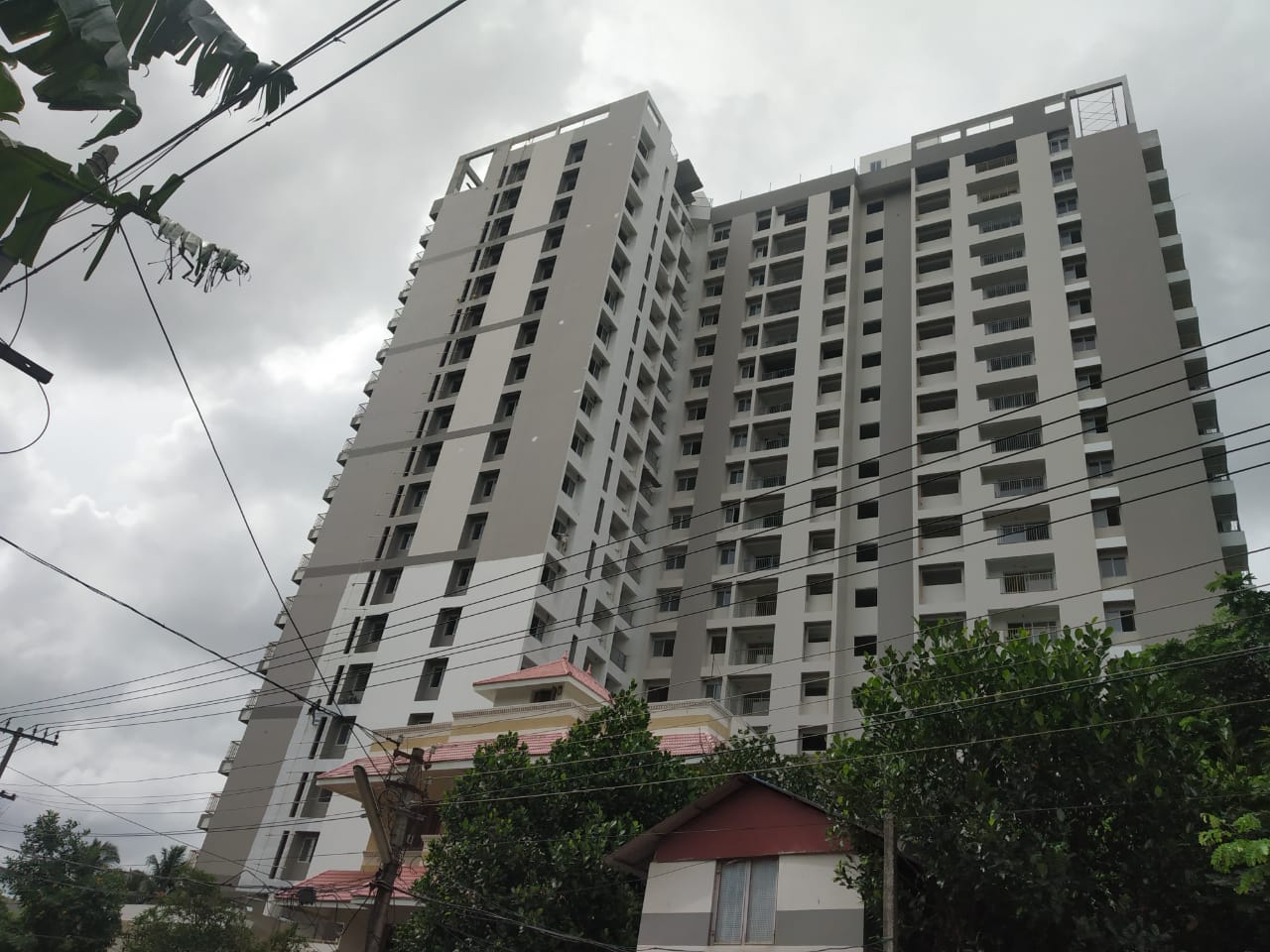

Artech Courtyard - Progress

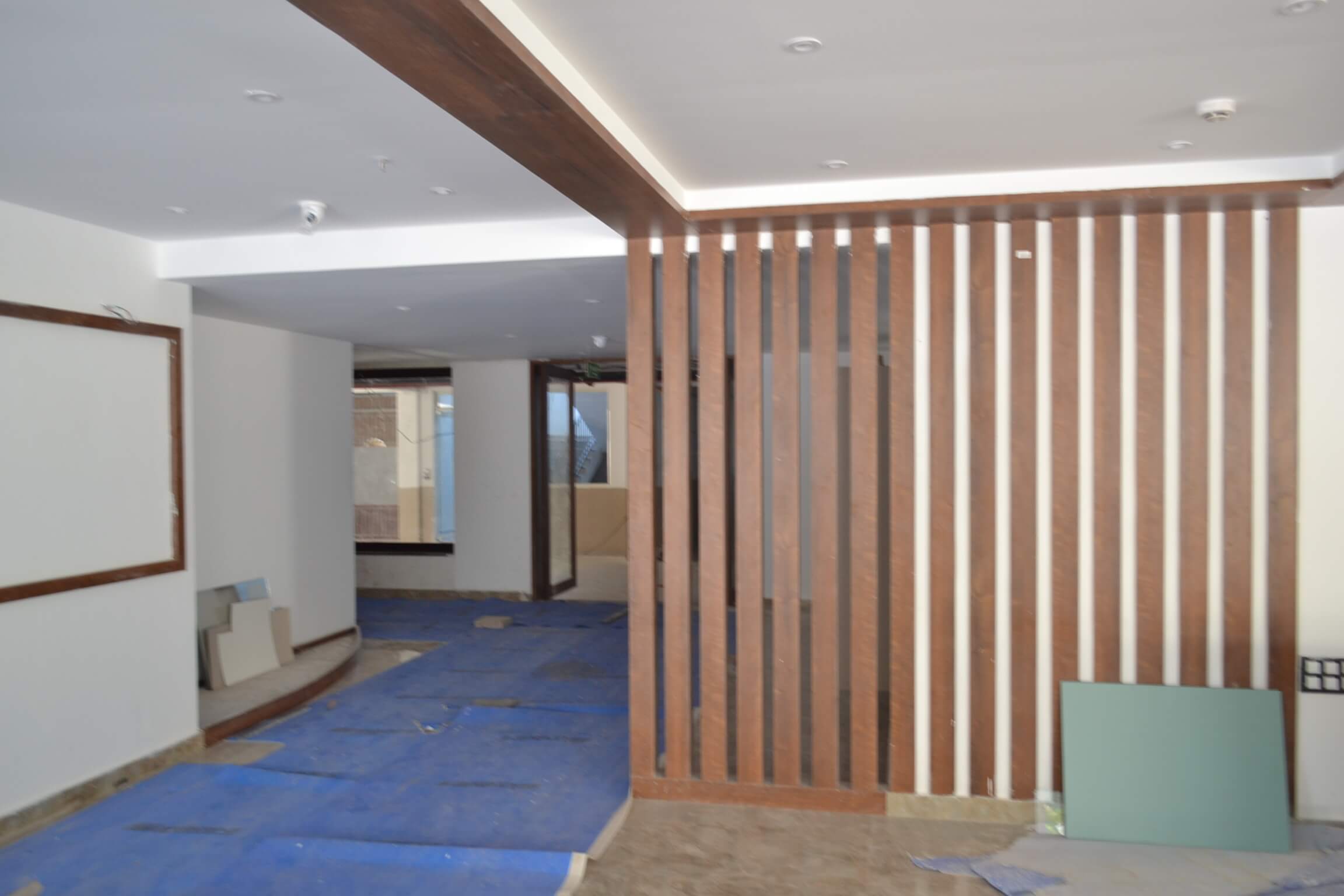

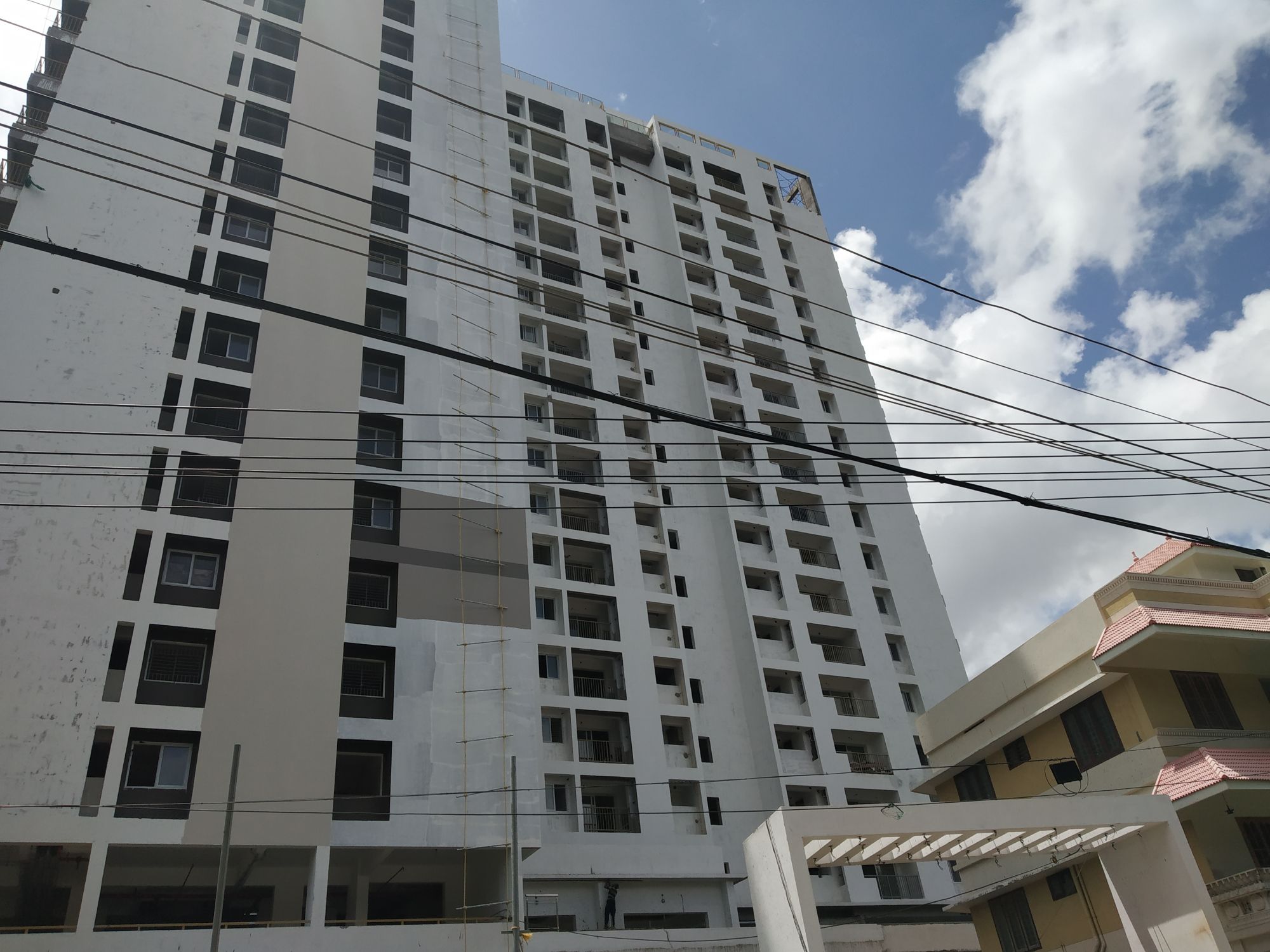

We are elated to announce that we have successfully completed our prestigious project “Courtyard”
As per the current work status from our site, we are targeted to complete the following works by the end of January 2020
- Wire pulling work -116 flats to be completed
- DB fixing -116 flats to be completed

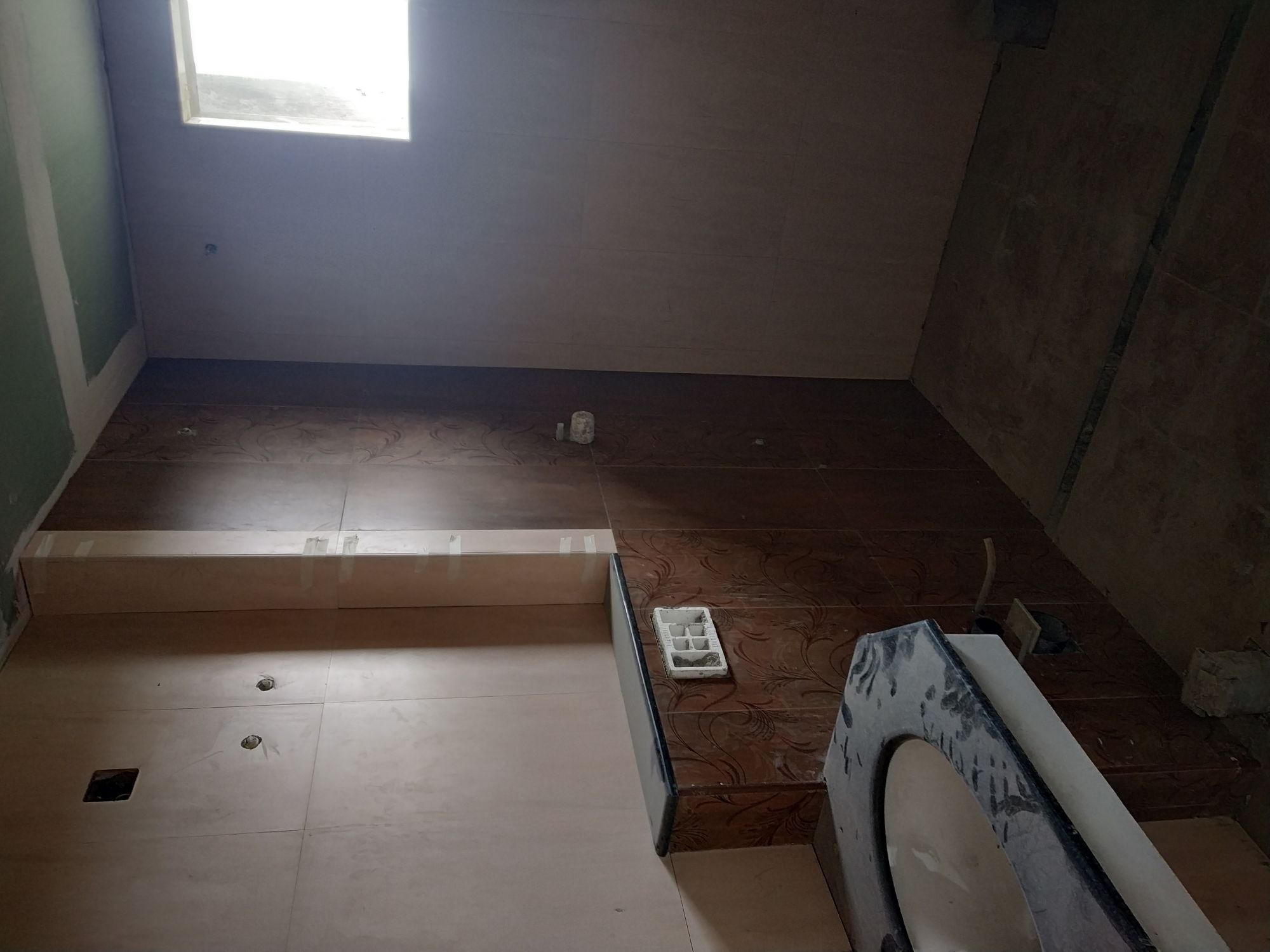

- CP &Sanitary fittings : 35Flats to be completed

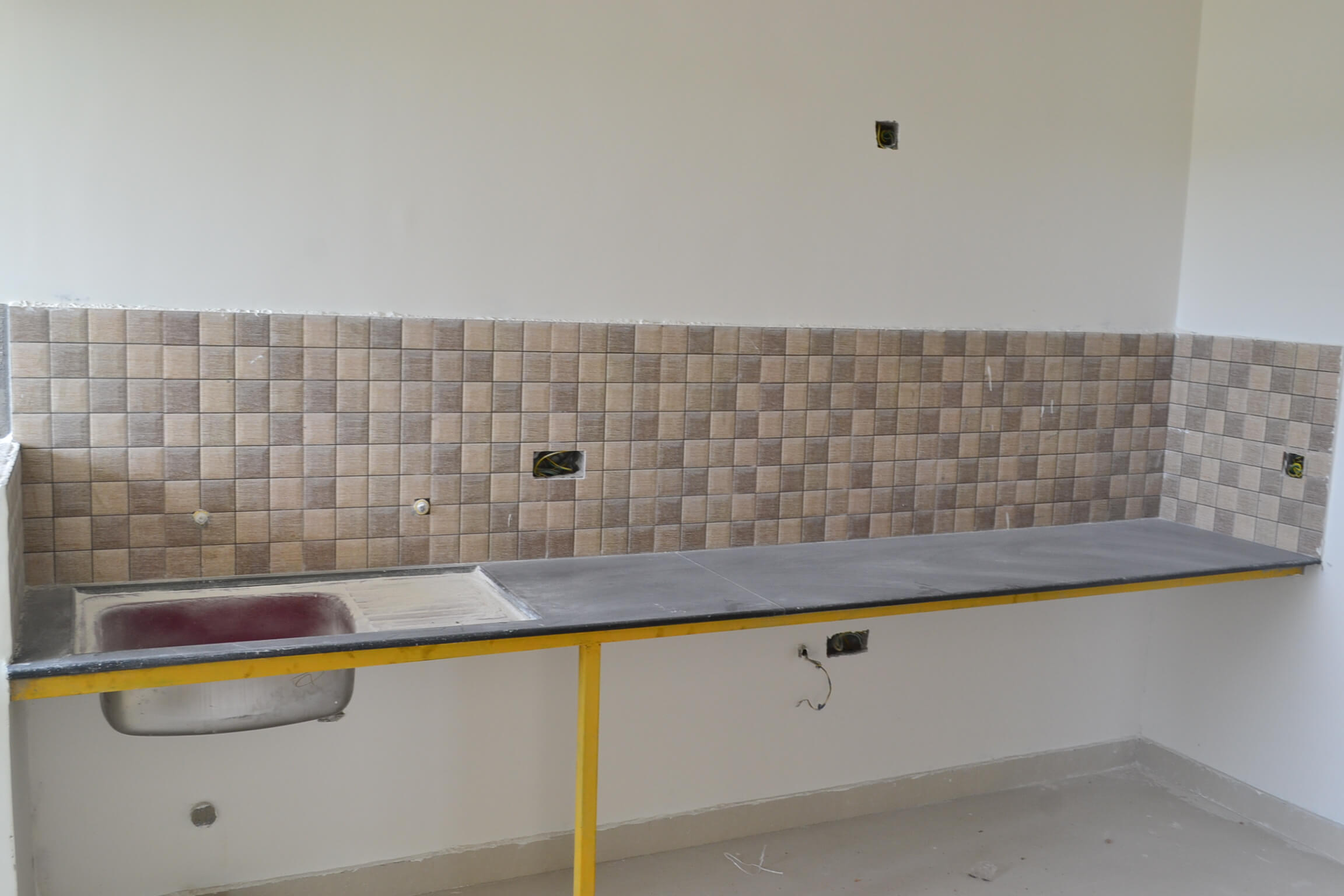

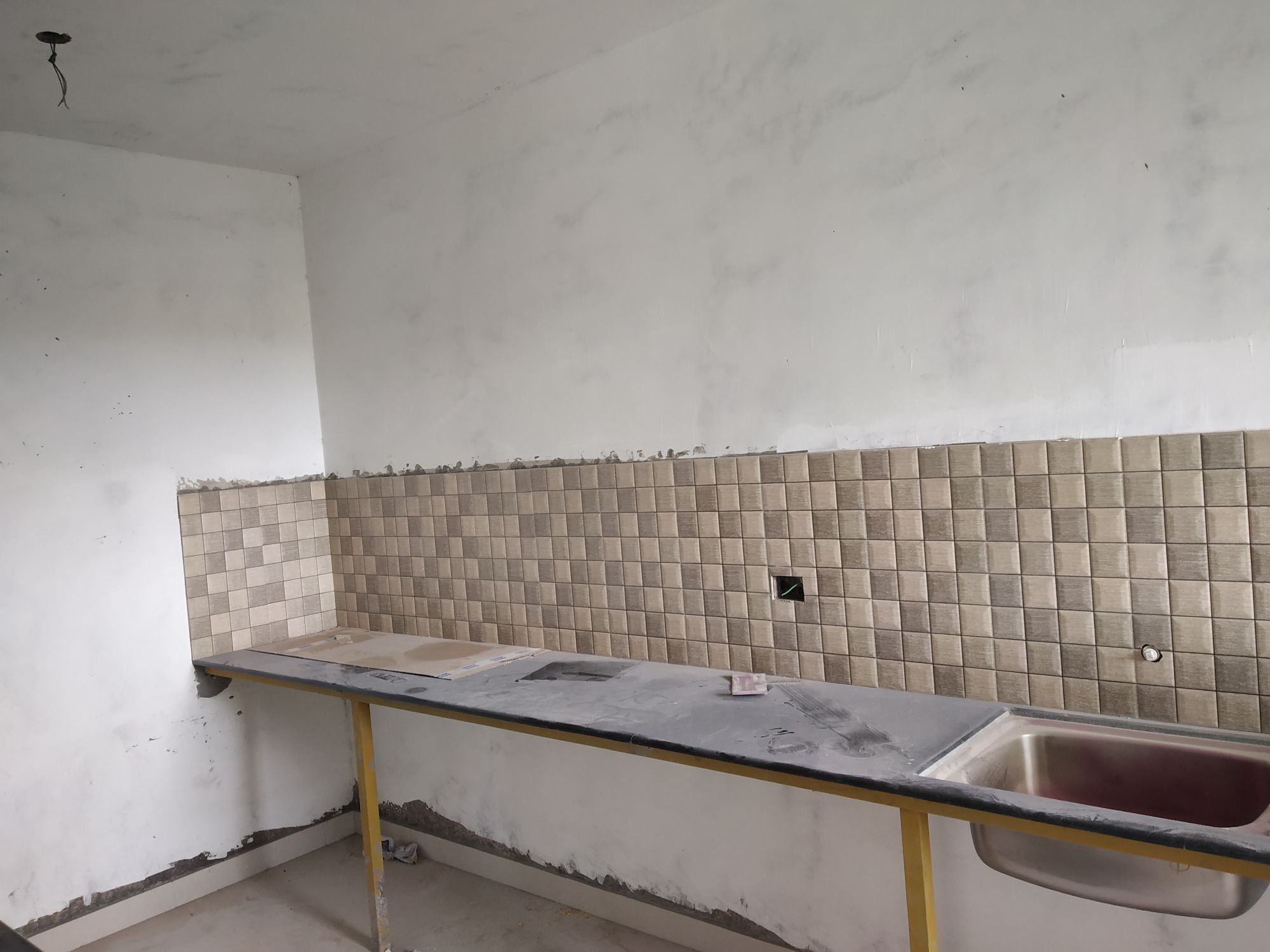

- Tiling work -116 flats to be completed (out of 119)

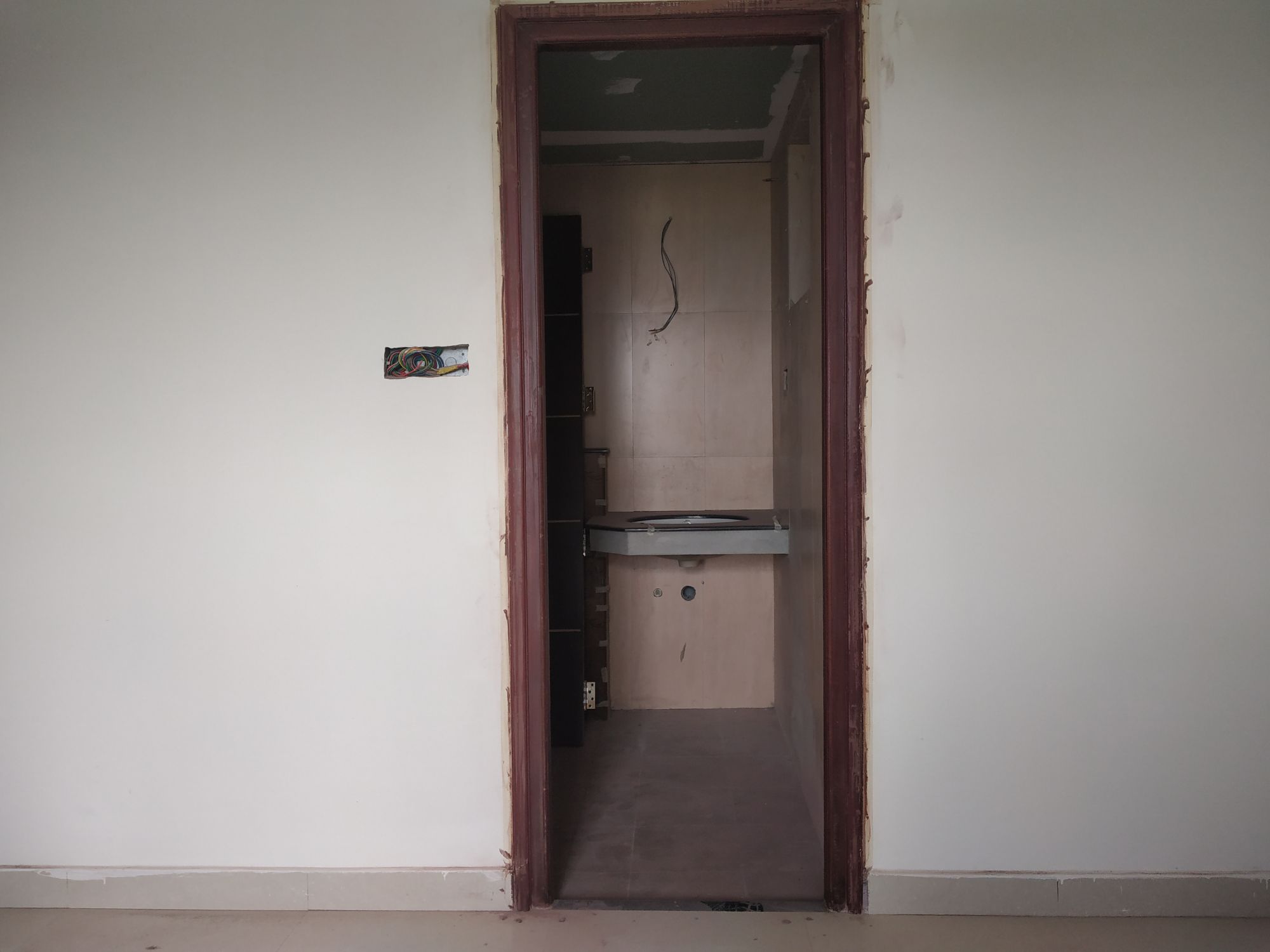

- Inside Putty work (2nd coat) -110 flats to be completed
- Inside primer work -106 flats (out of 119) completed
- Aluminium Fabrication work – 95% to be completed
- Firework-100% to be completed

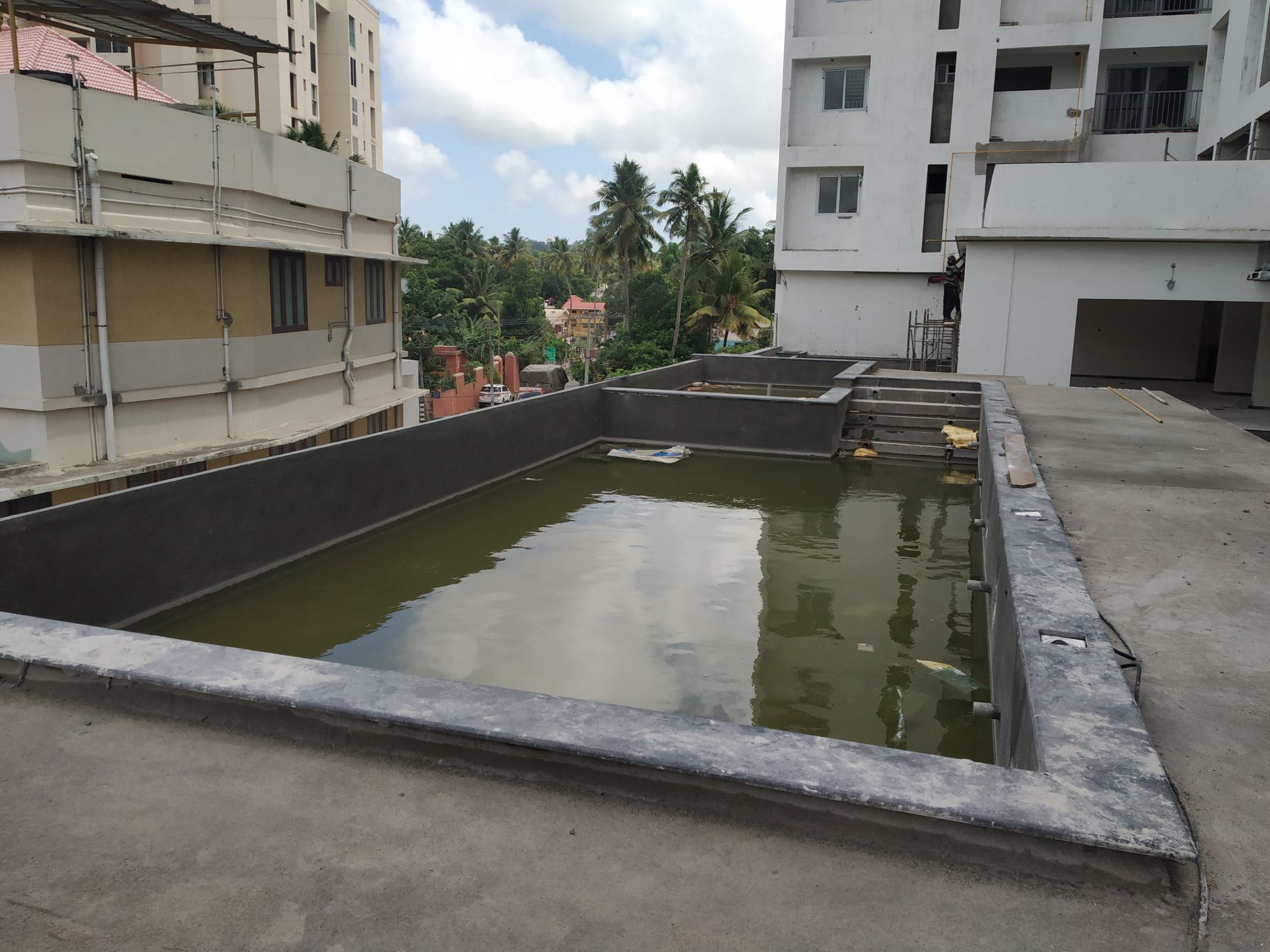

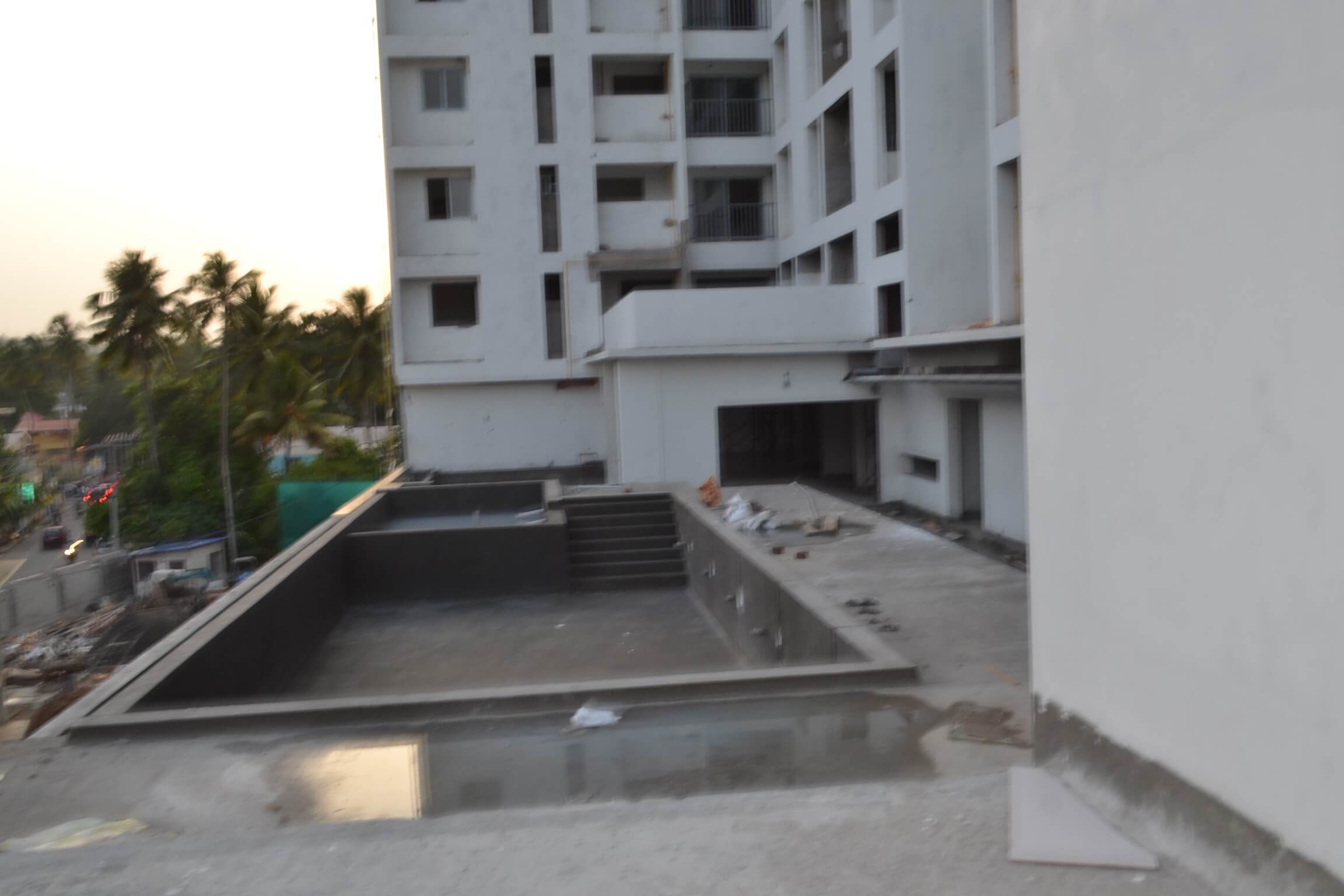

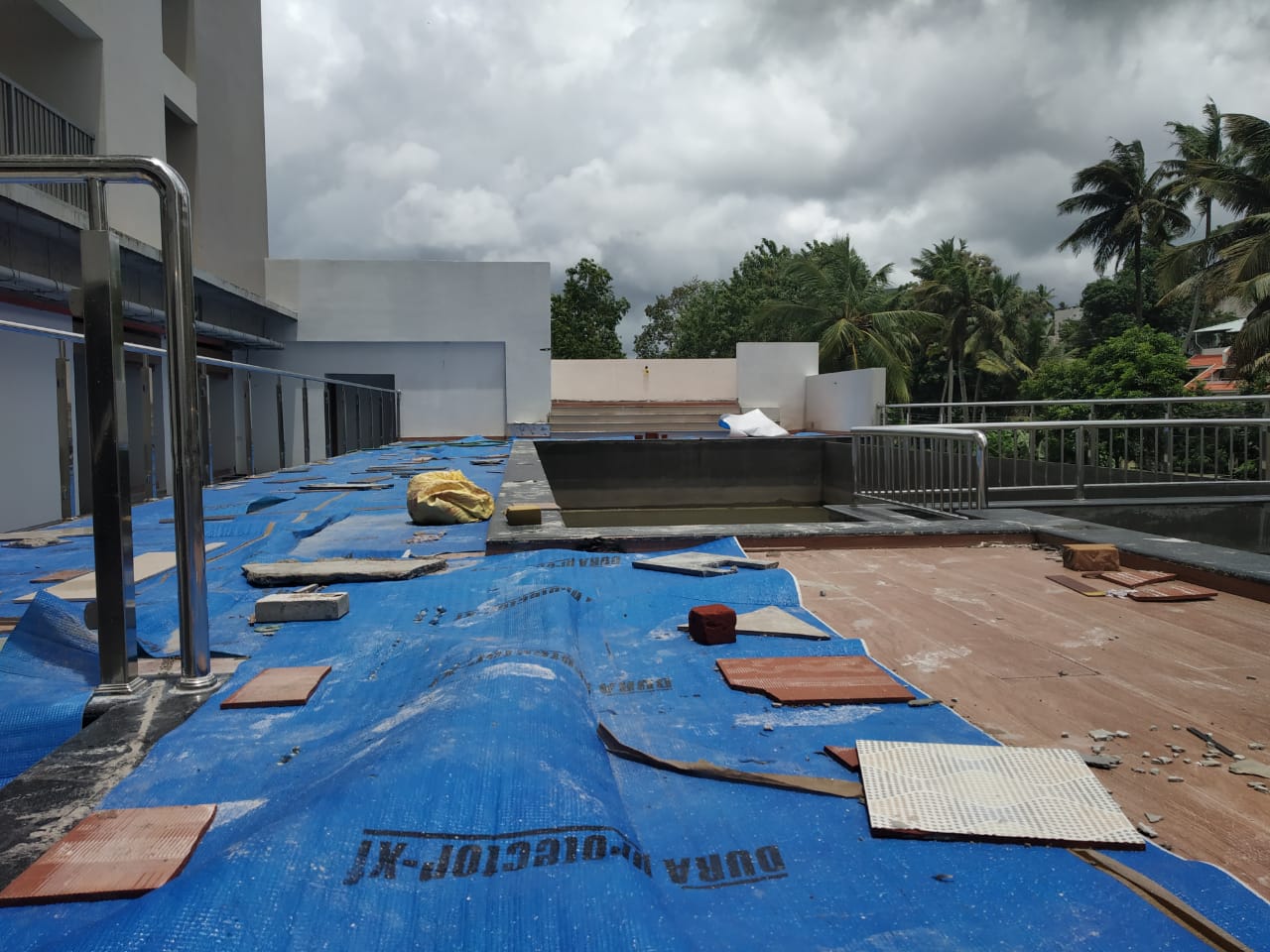

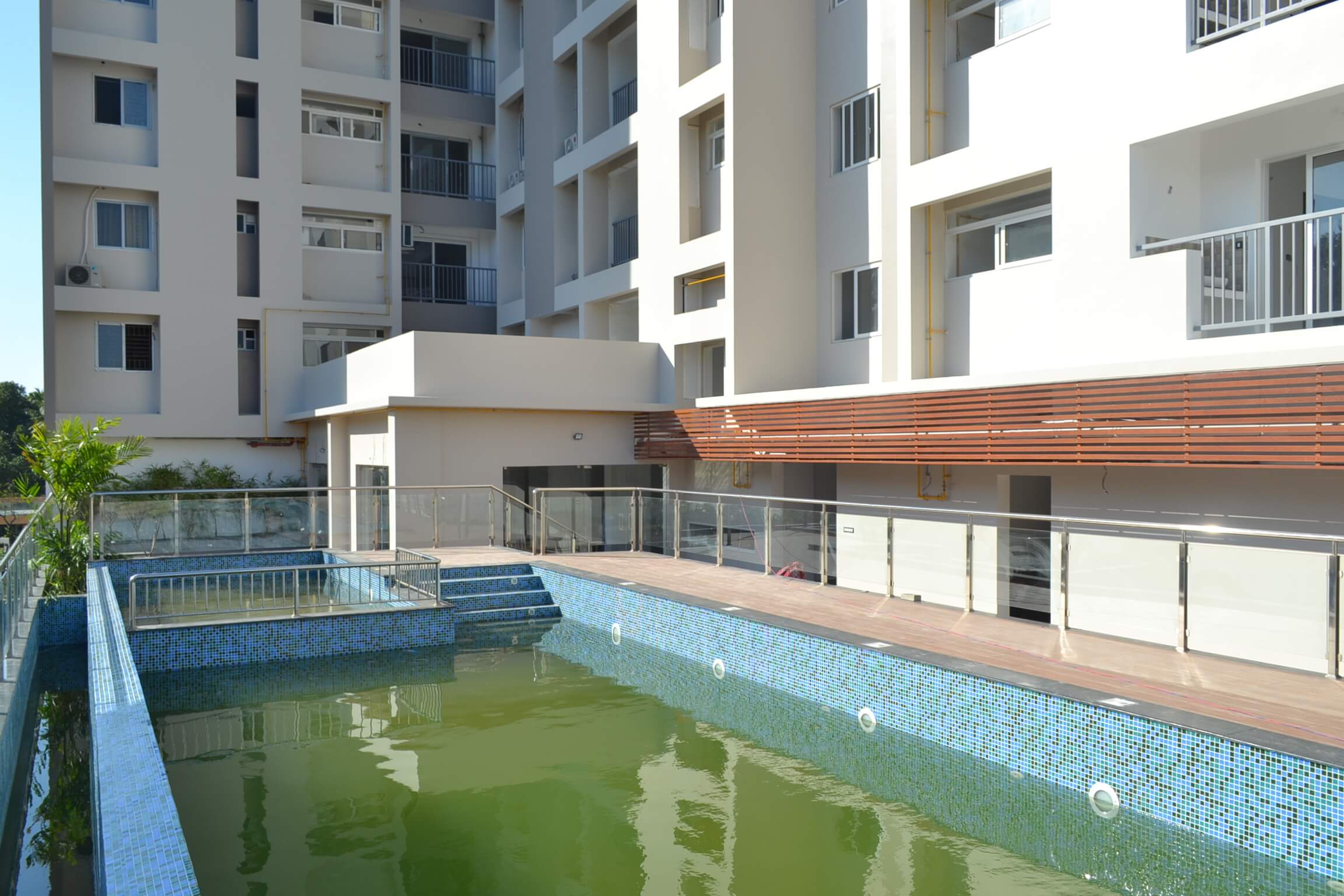

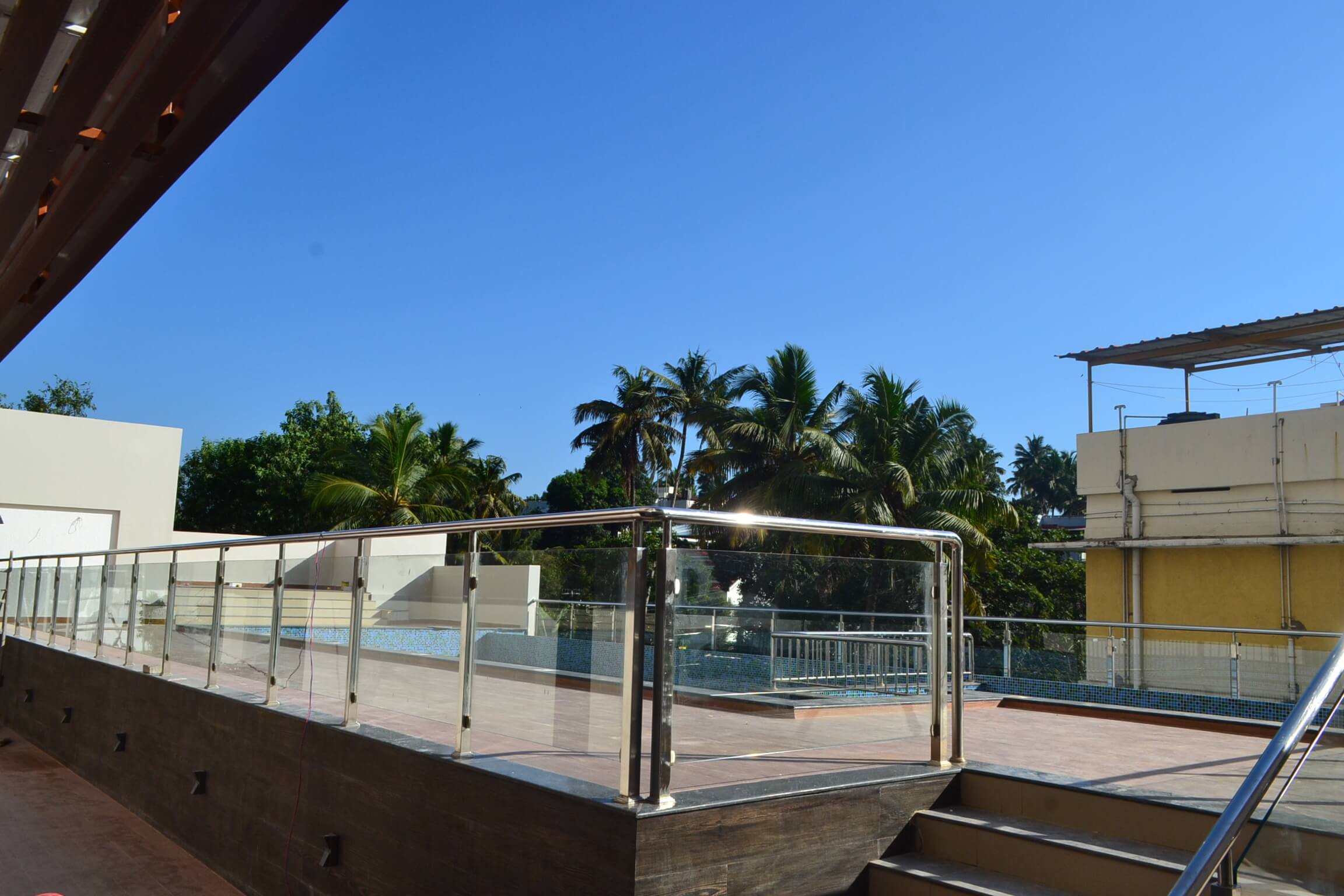

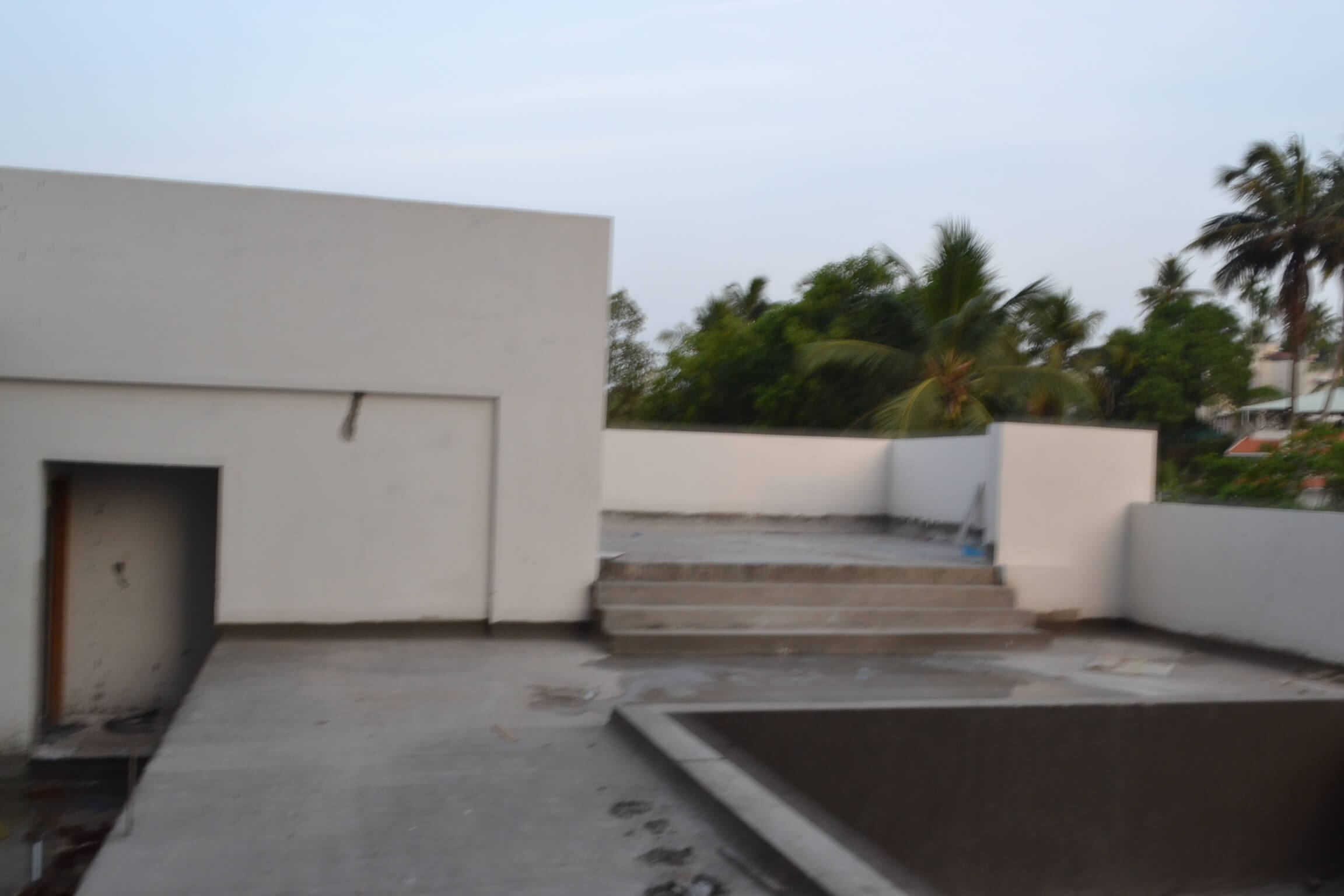

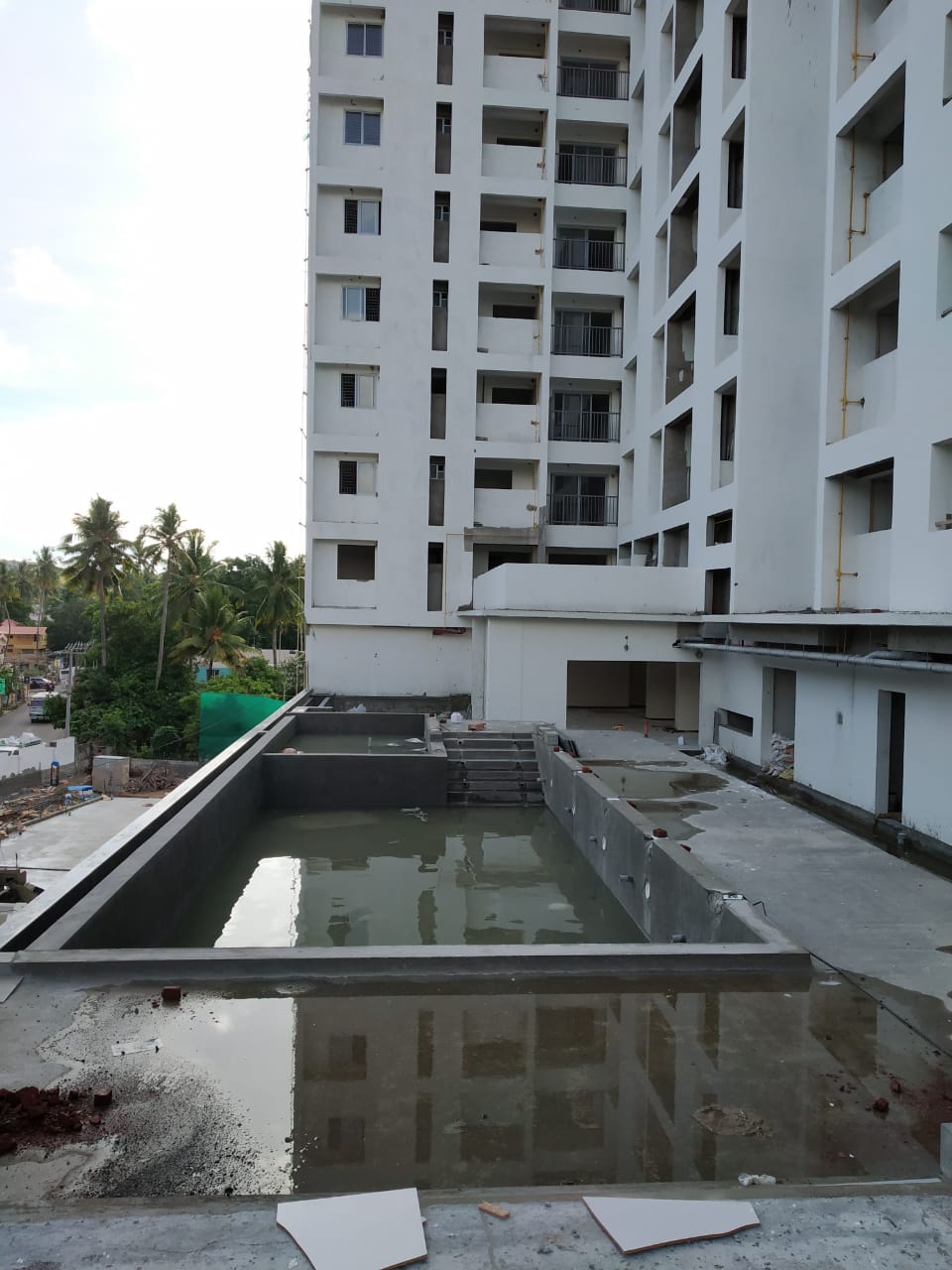

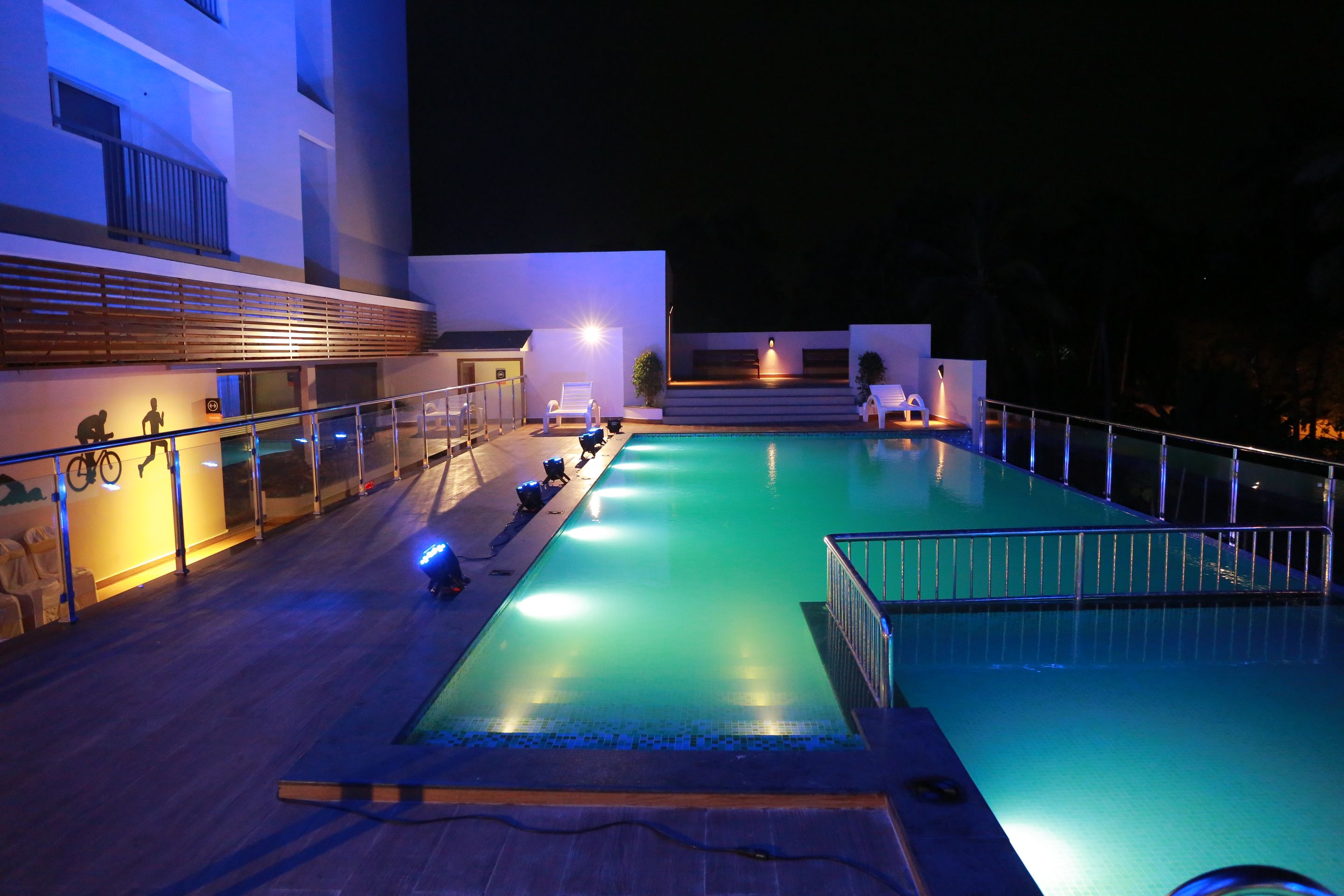

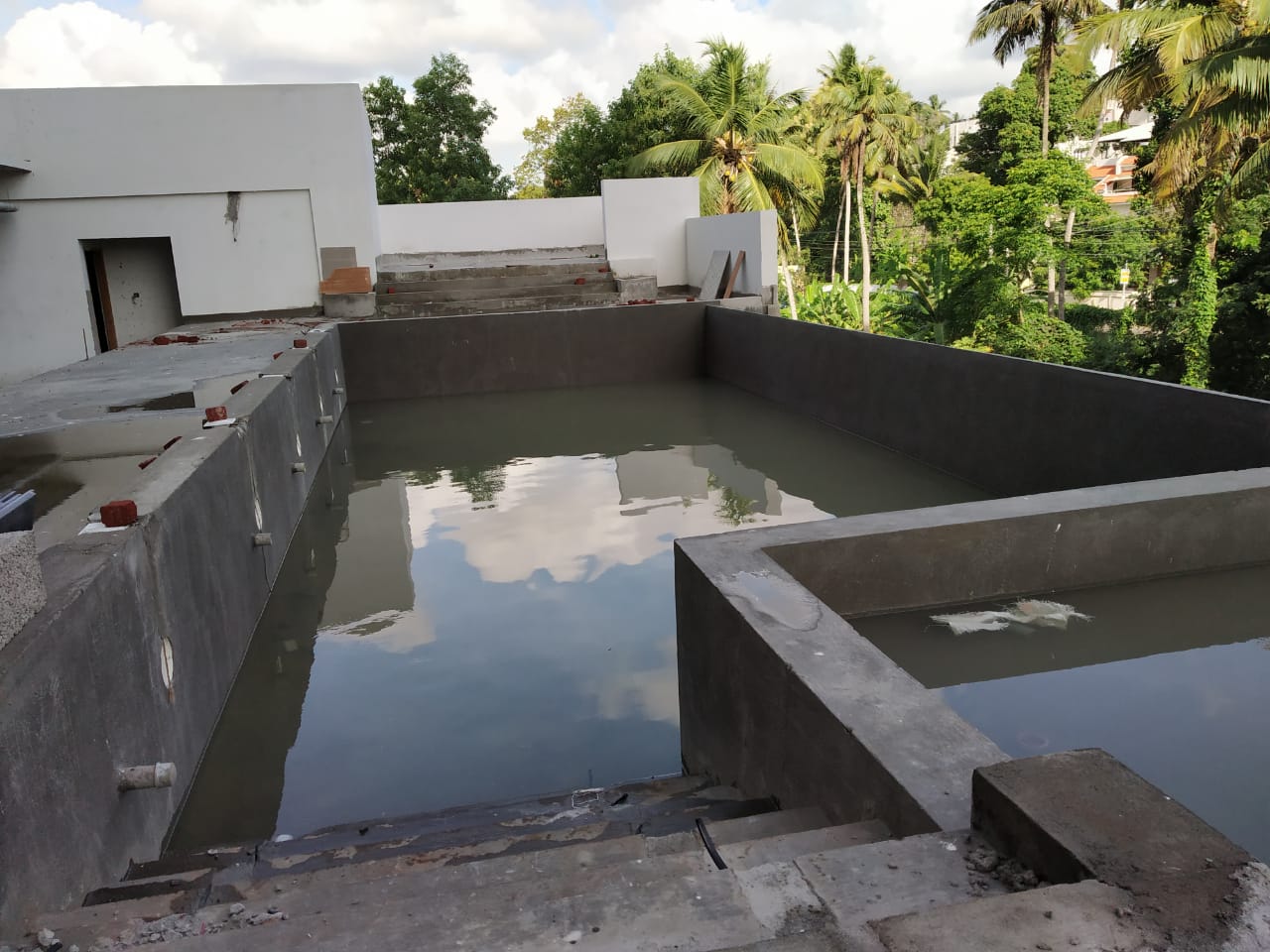

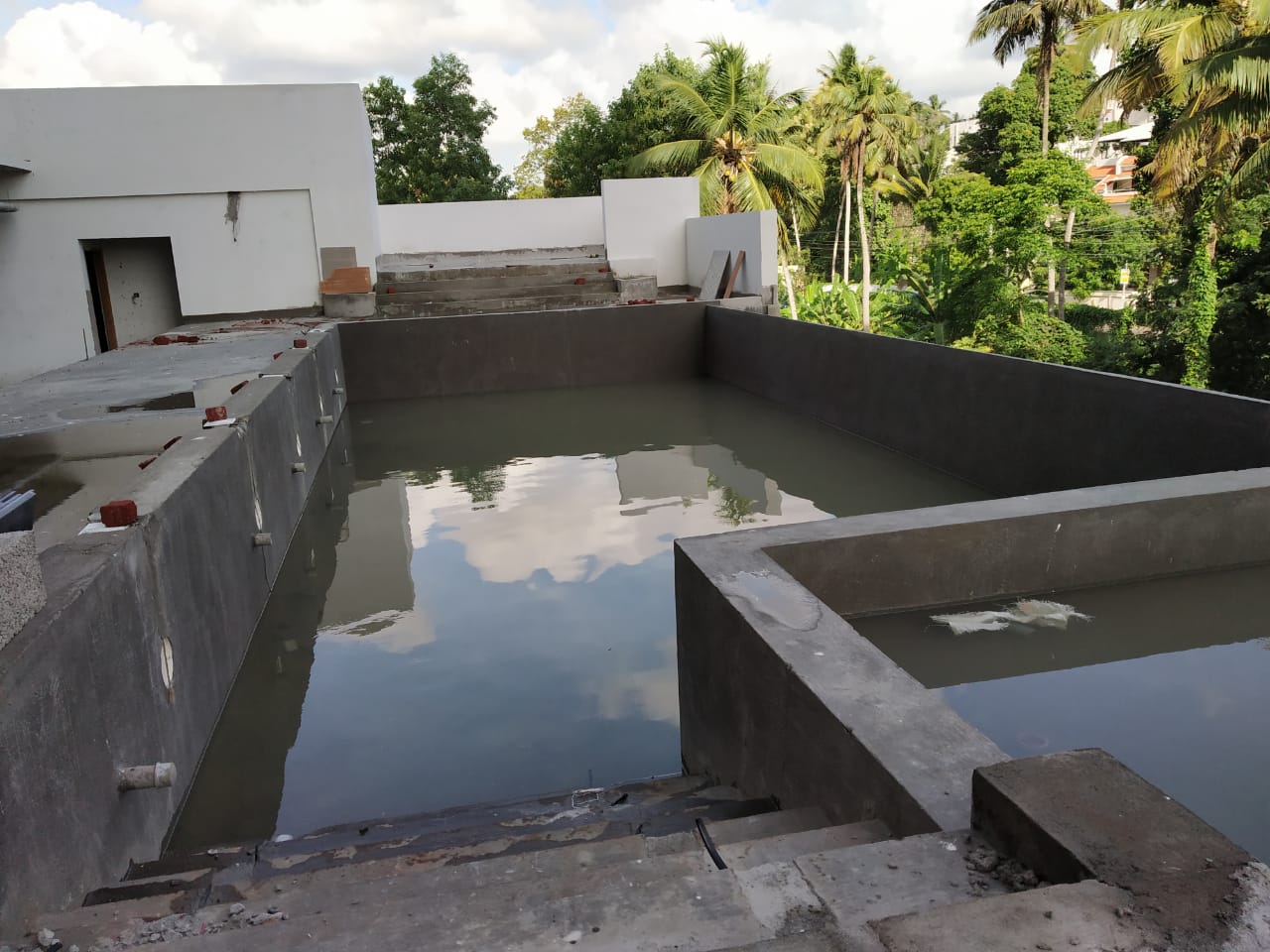

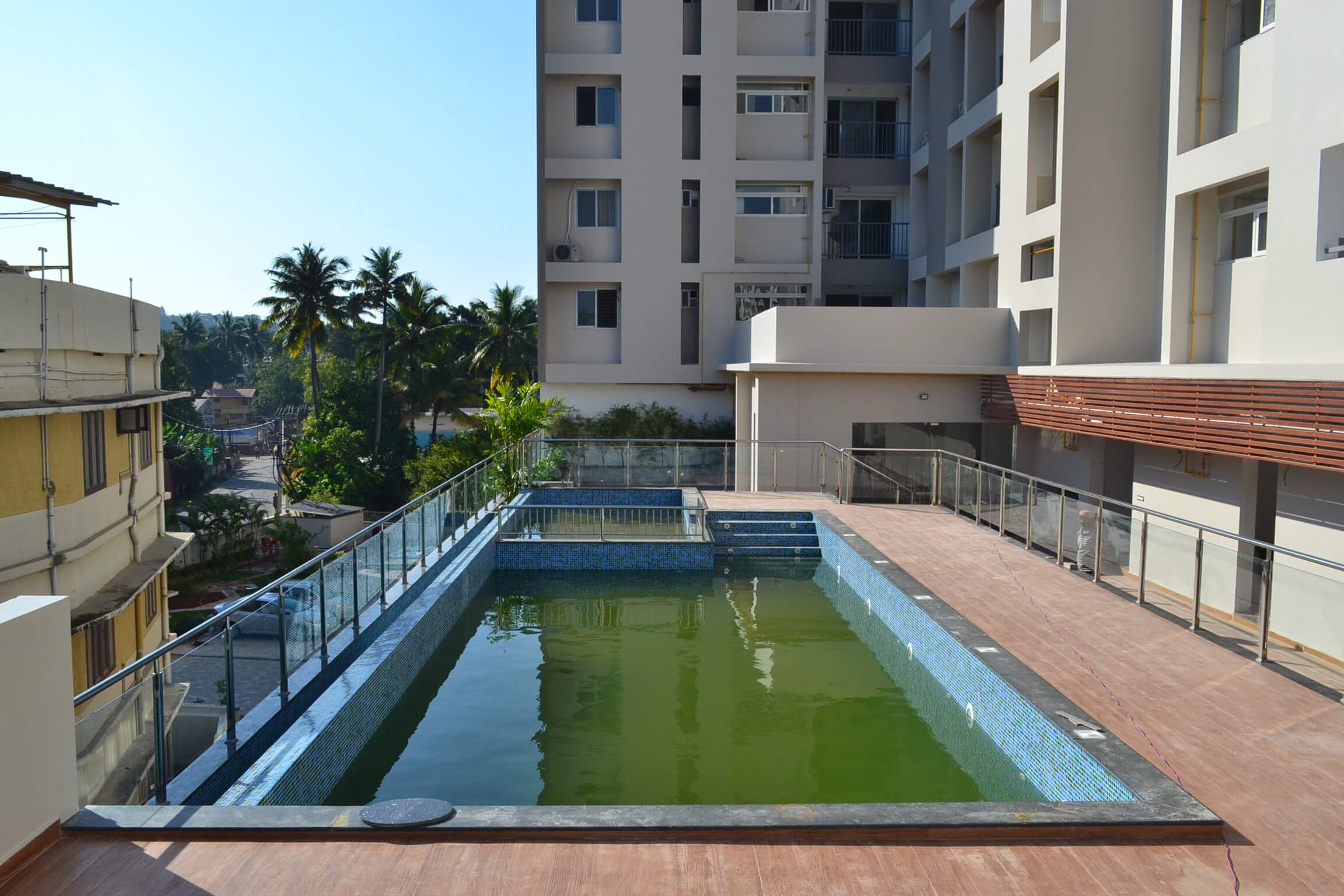

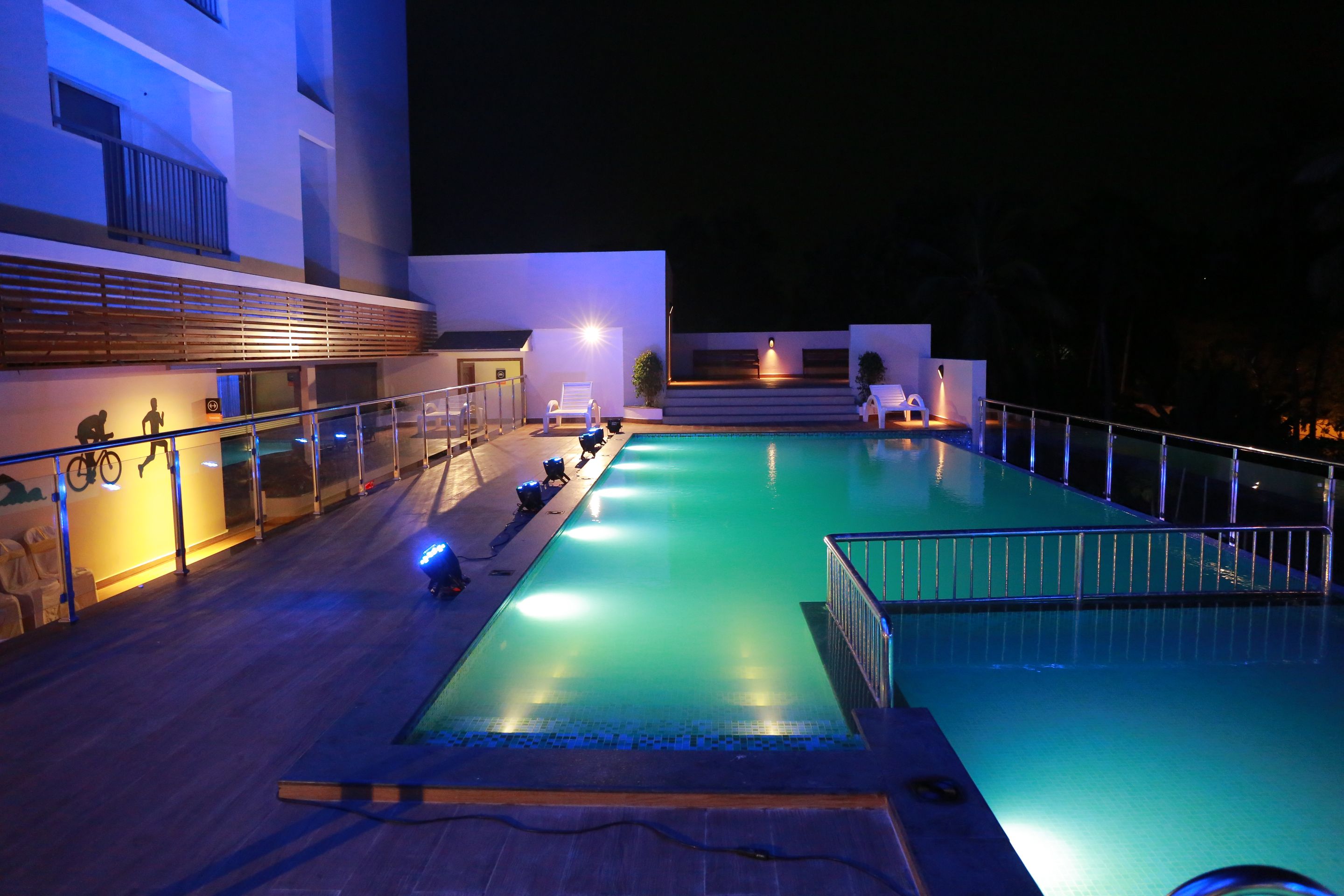

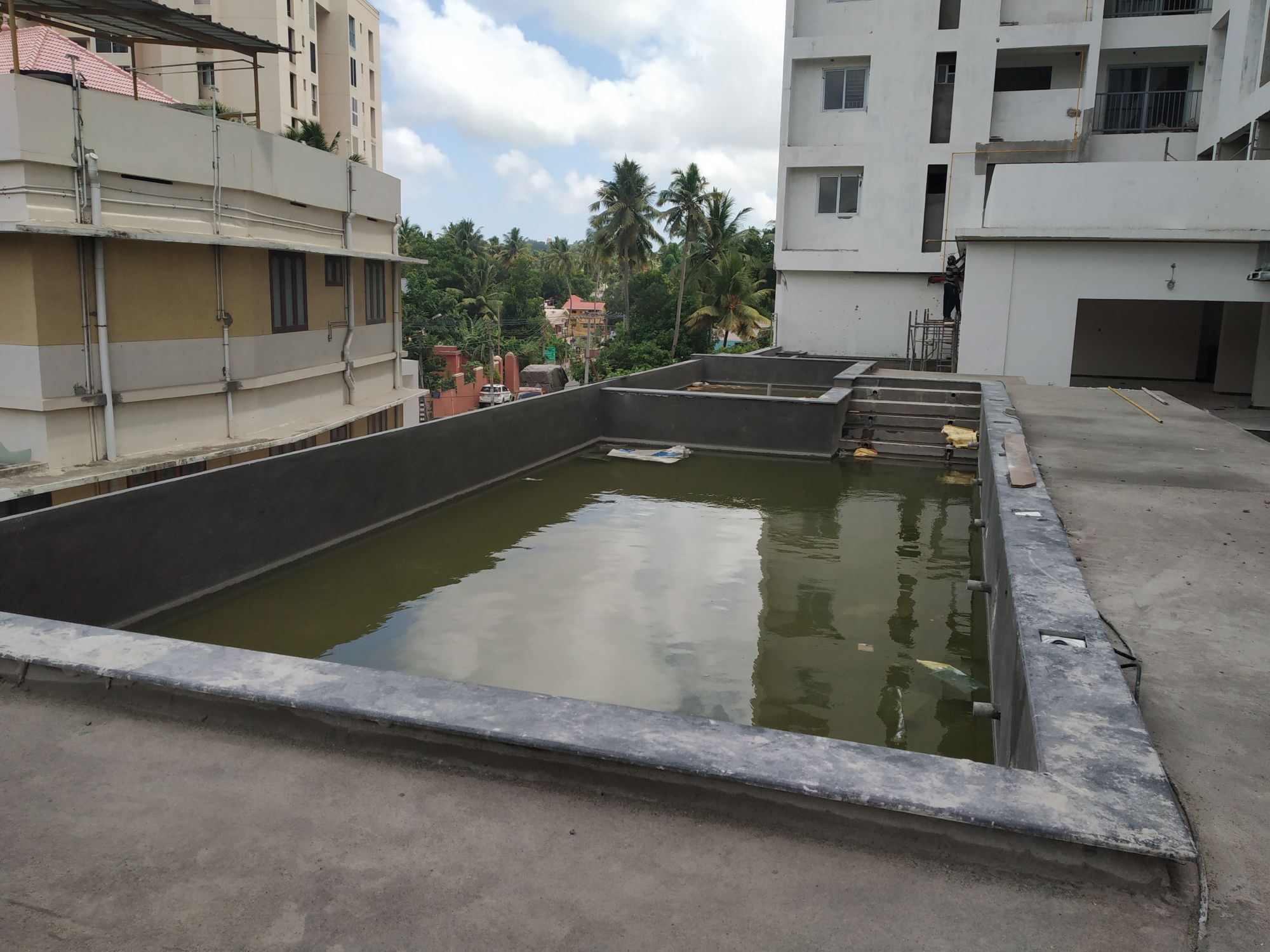

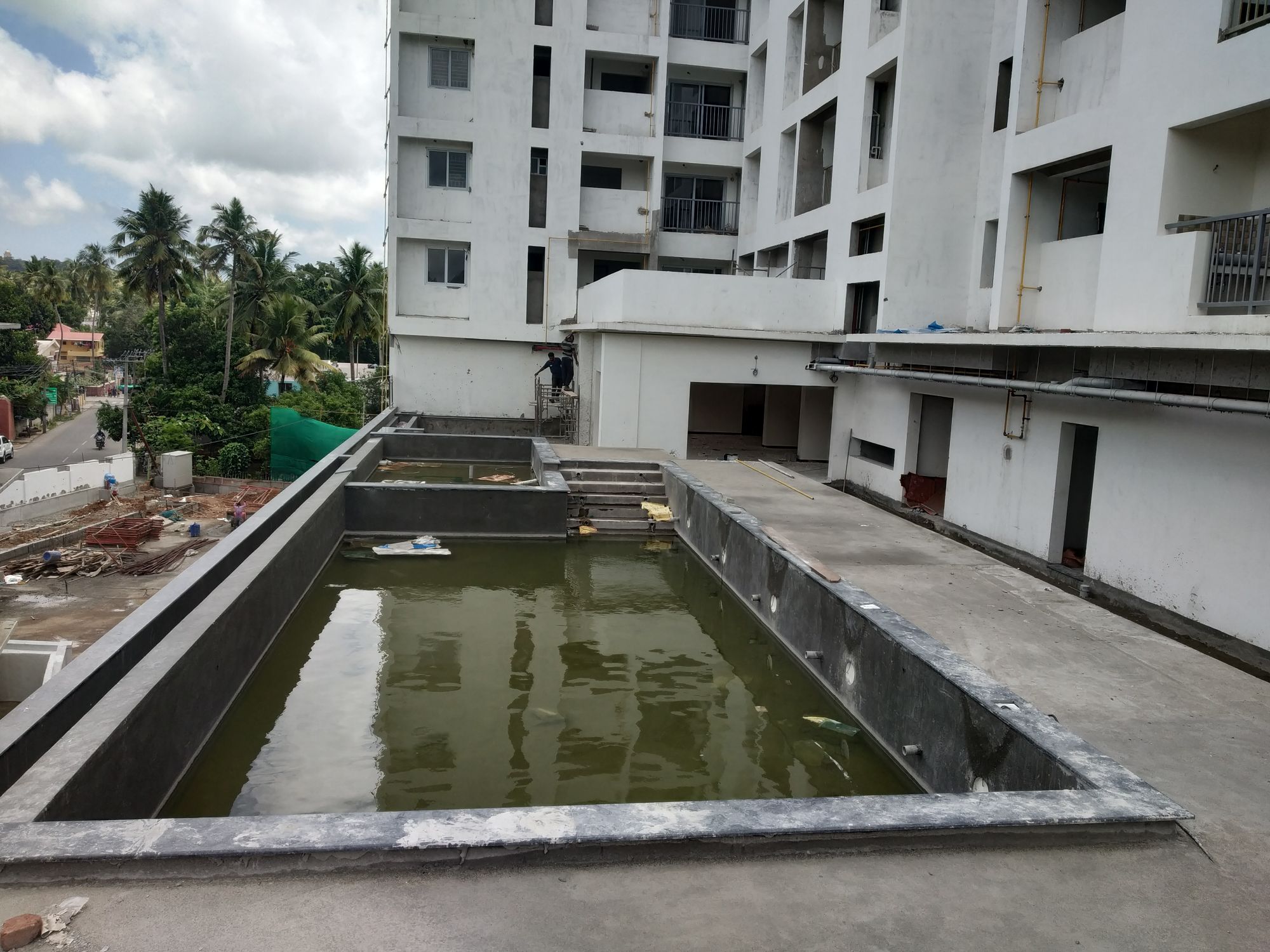

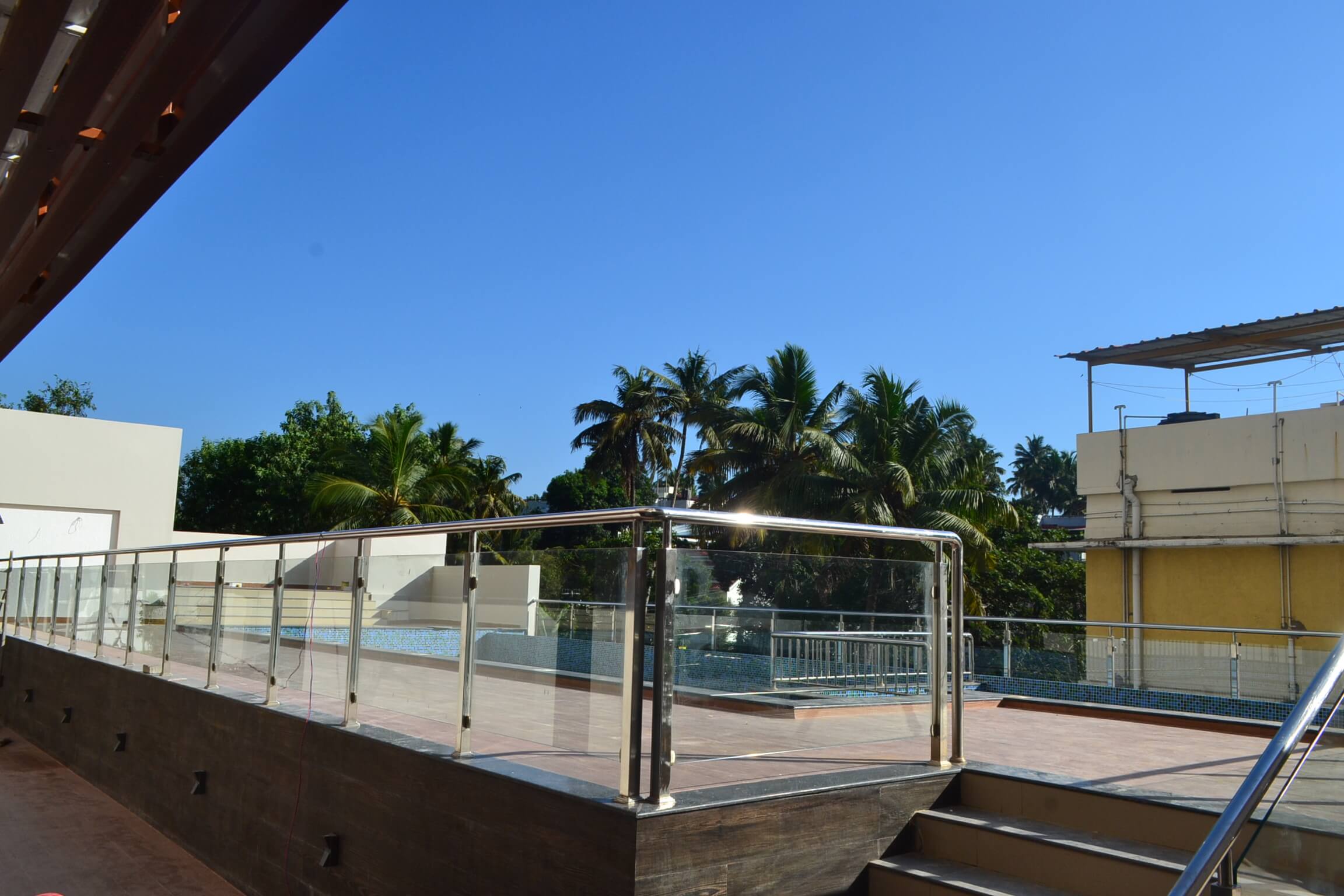

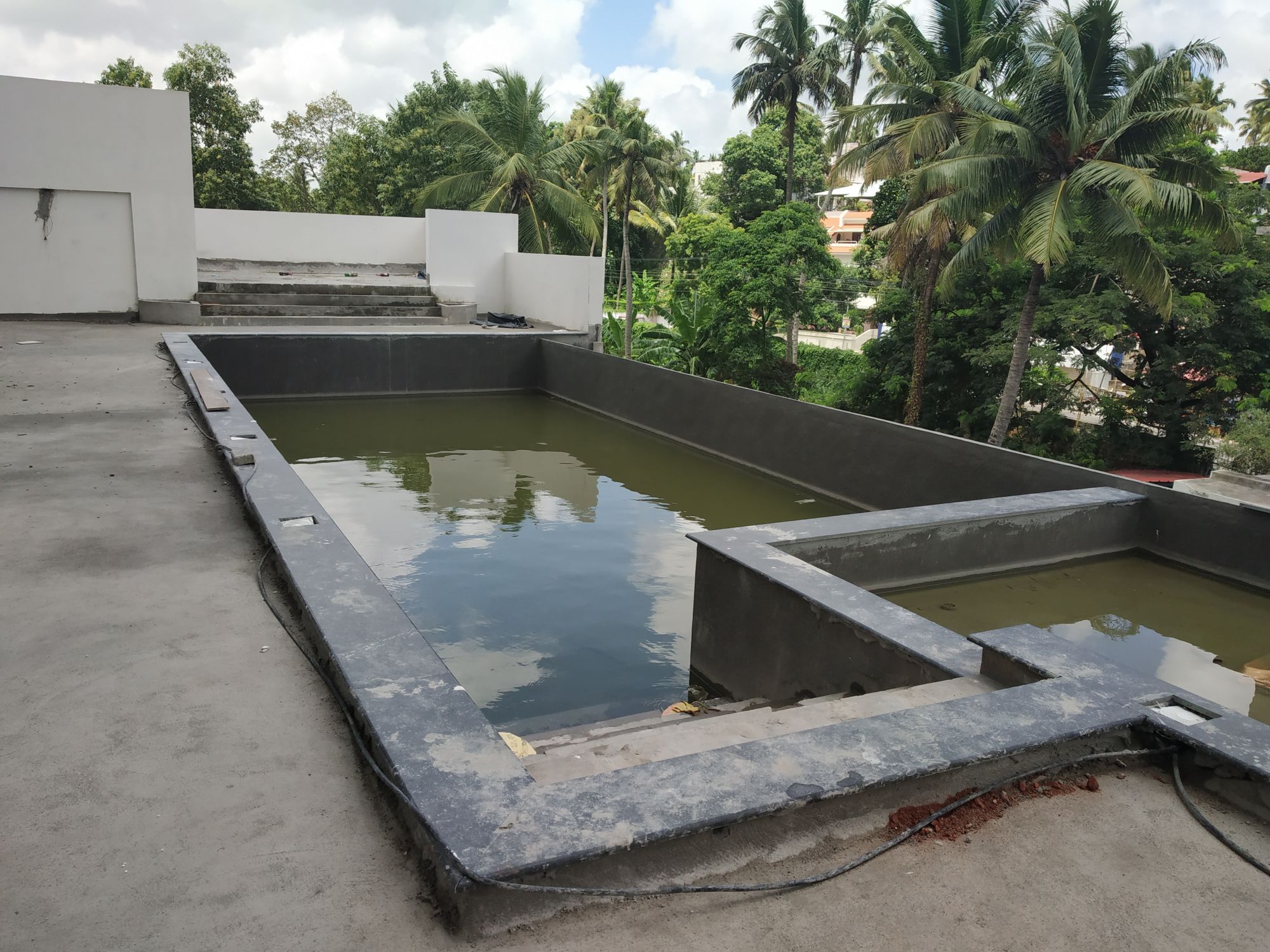

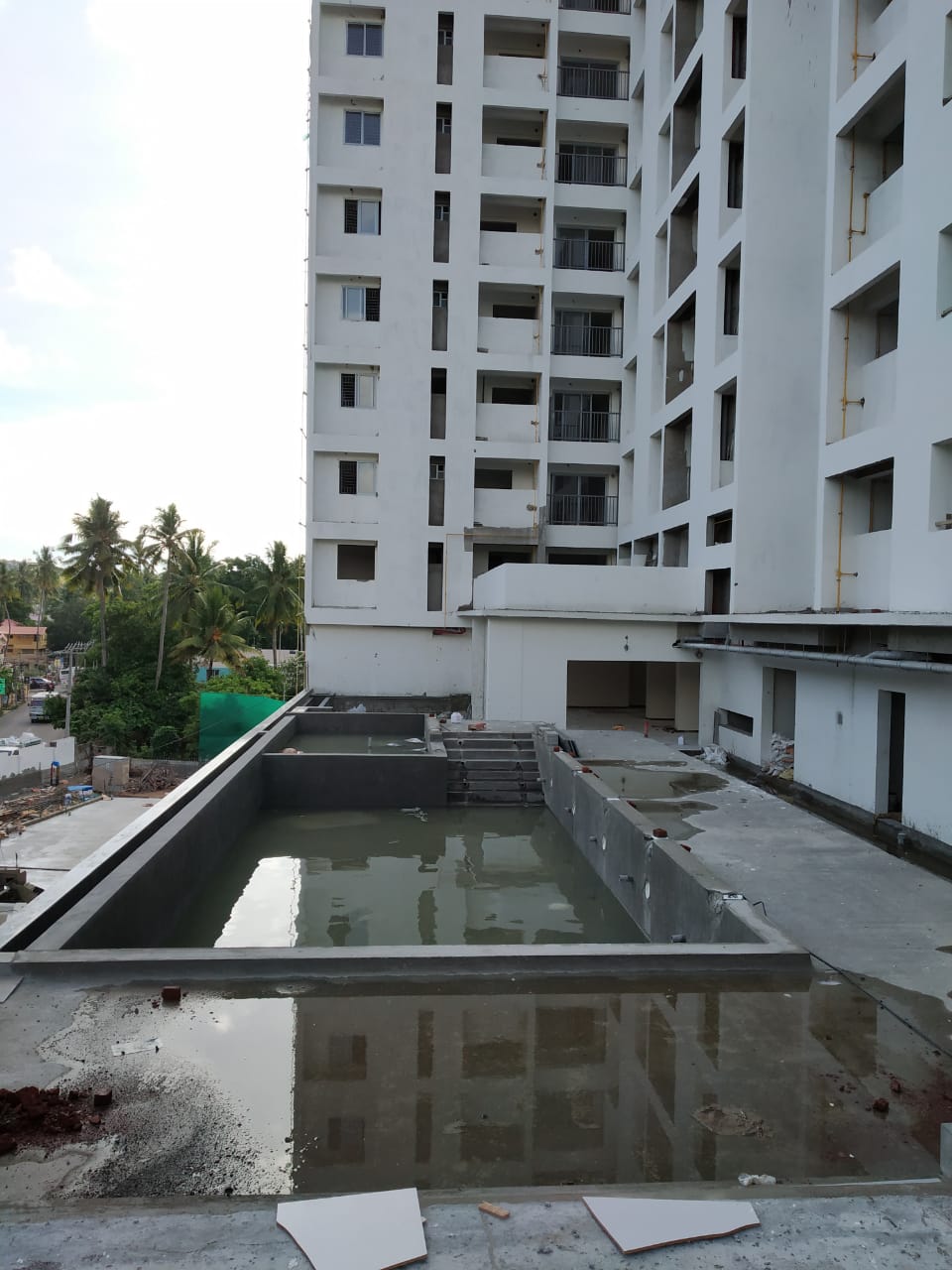

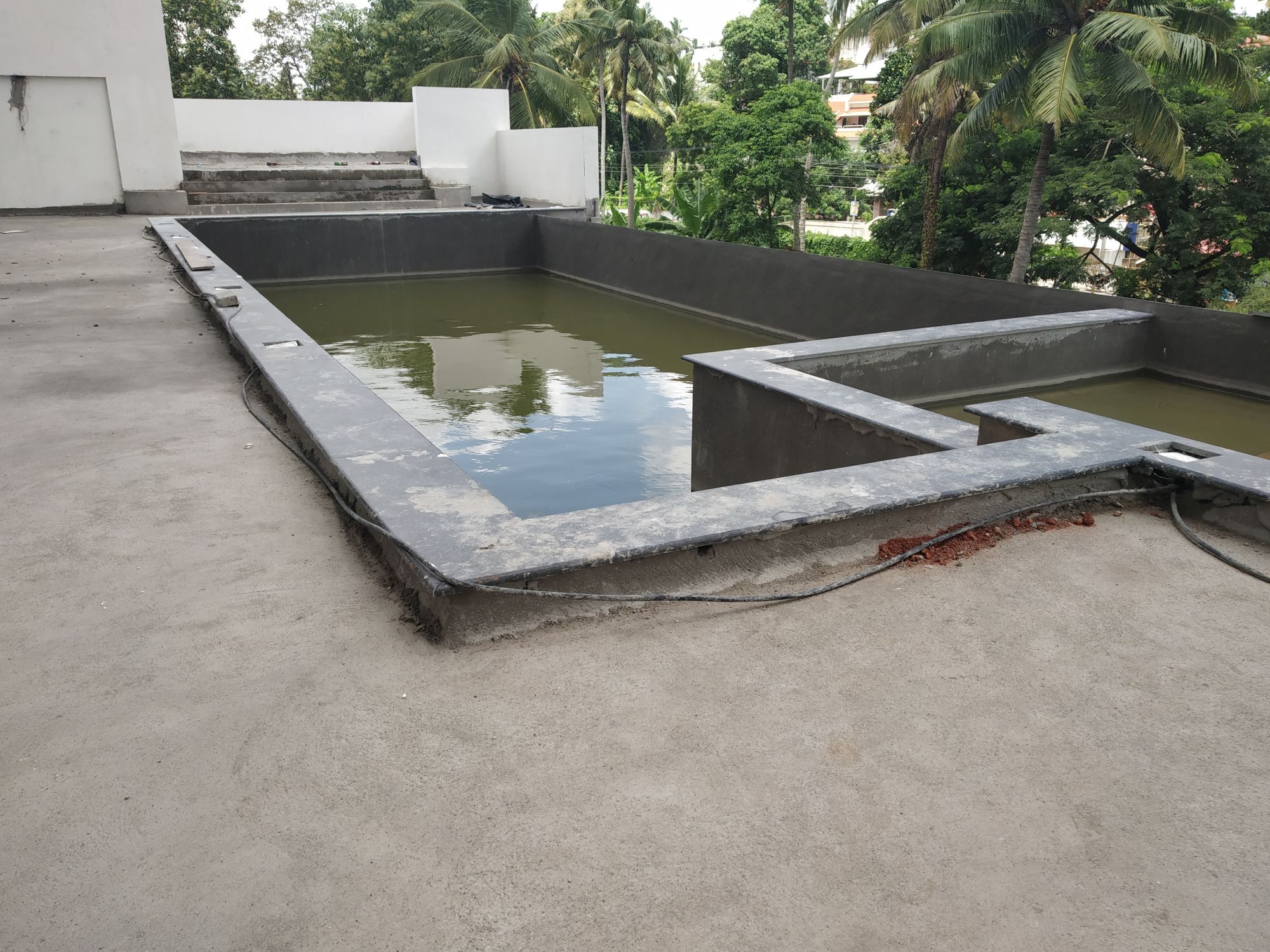

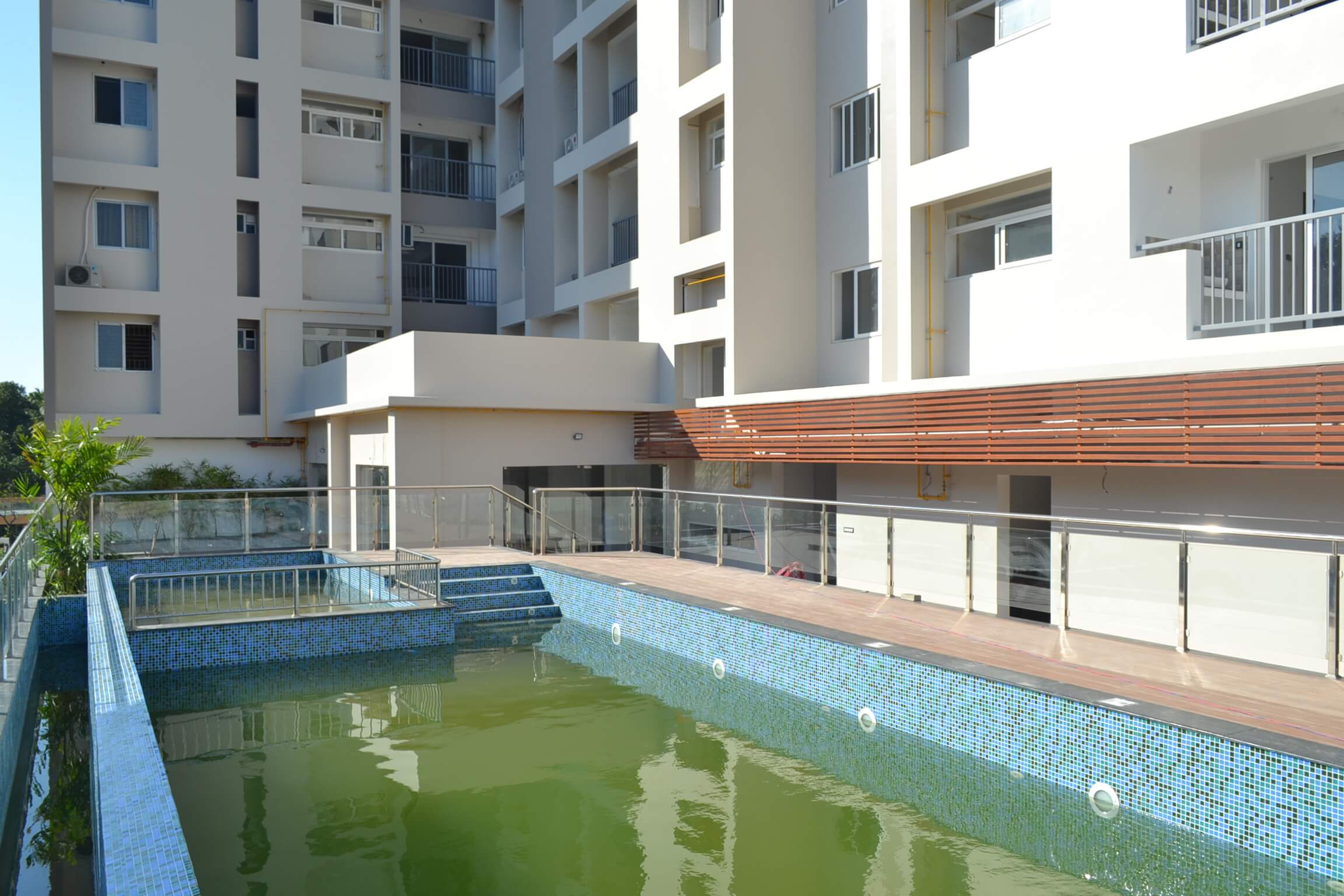

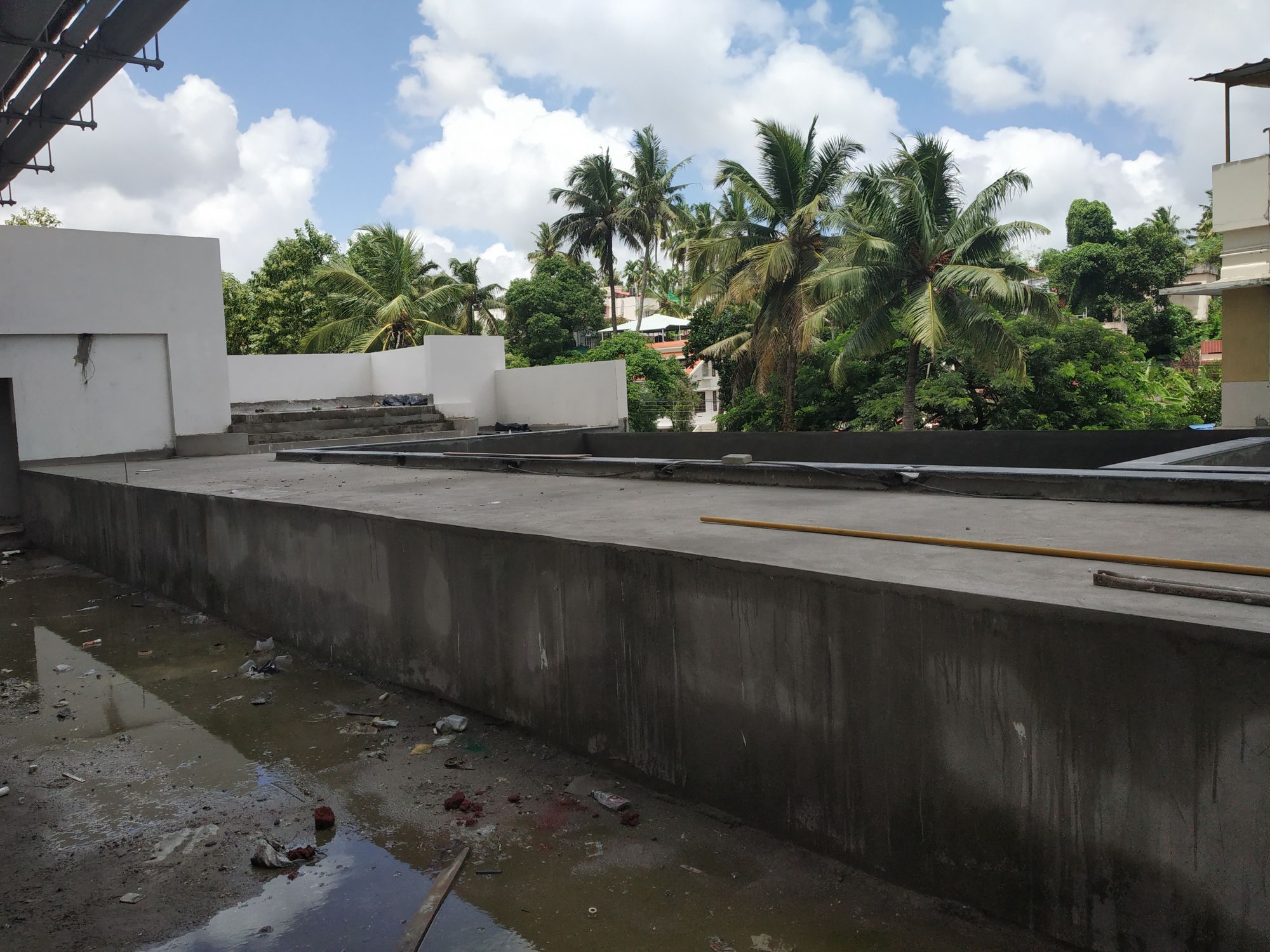

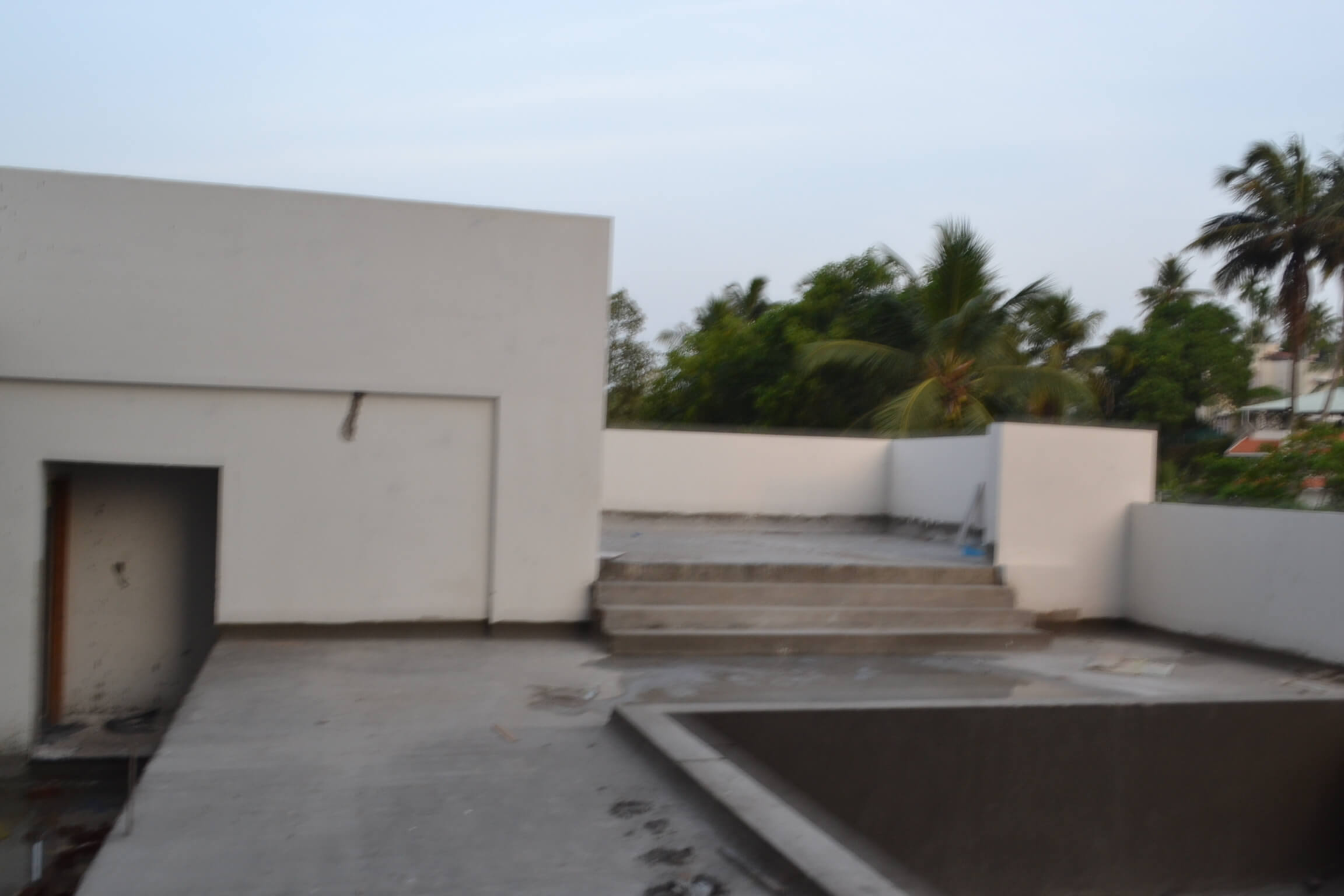

- Swimming pool work – 100% to be completed
- Reticulated gas work-100% to be completed
Work status as on 10-01-2020, we have completed the following.
- RCC for Structure – 100% completed
- Block/Brick masonry – 100% completed
- Door frame fixing – 100% completed
- Ceiling Plastering work – 100% completed
- Inside wall plastering work – 100% completed
- Wall chasing work – 100% completed
- Wire pulling work -114flats completed
- DB fixing -114flats completed
- Water Proofing work – 100% completed.
- Electrical HT work -100% completed
- Plumbing work -(internal lines-100% Completed, plumbing work on ground floor and yard- 100% completed
- CP &Sanitary fittings :29 flats (Out of 119) Flats completed

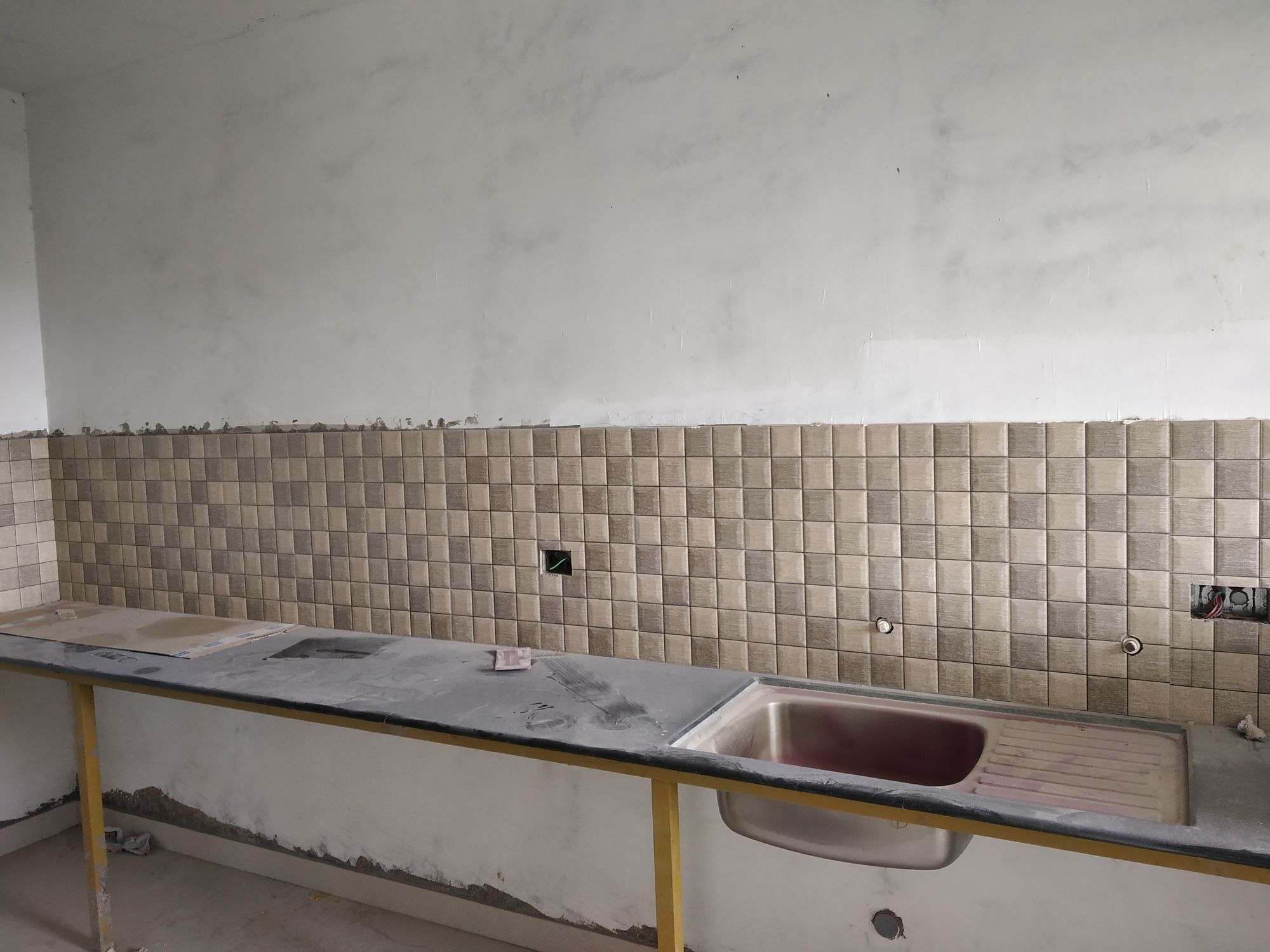

- Tiling work -114 flats completed (out of 119)
- External Plastering work – 100% completed

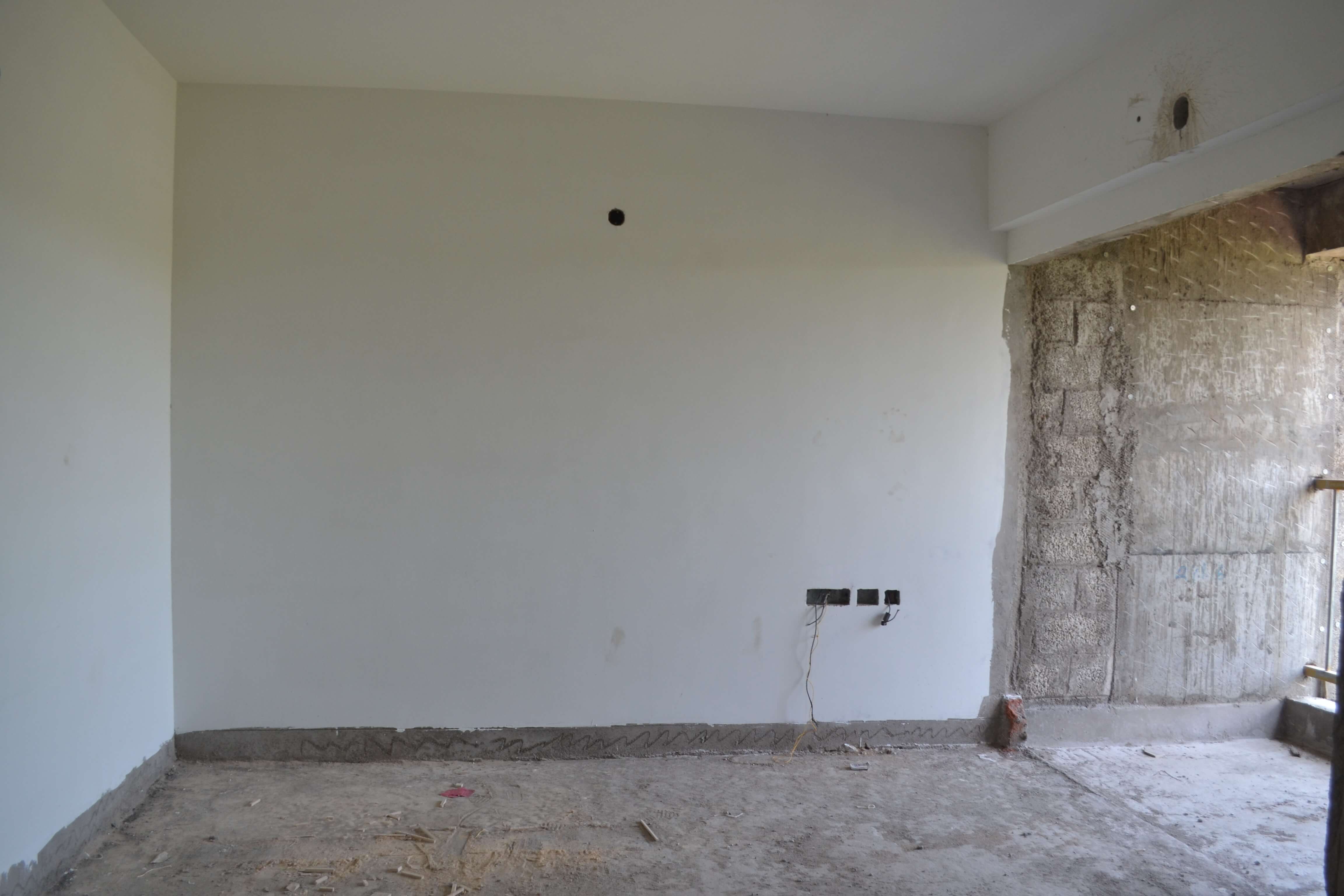

- Inside Putty work (1 coat) -100% completed
- Inside Putty work (2nd coat) – 100 flats(out of 119) completed
- Inside primer work -100 flats (out of 119) completed
- External primer work – 100% completed
- Aluminium Fabrication work -90% completed
- Fire Work-98%completed

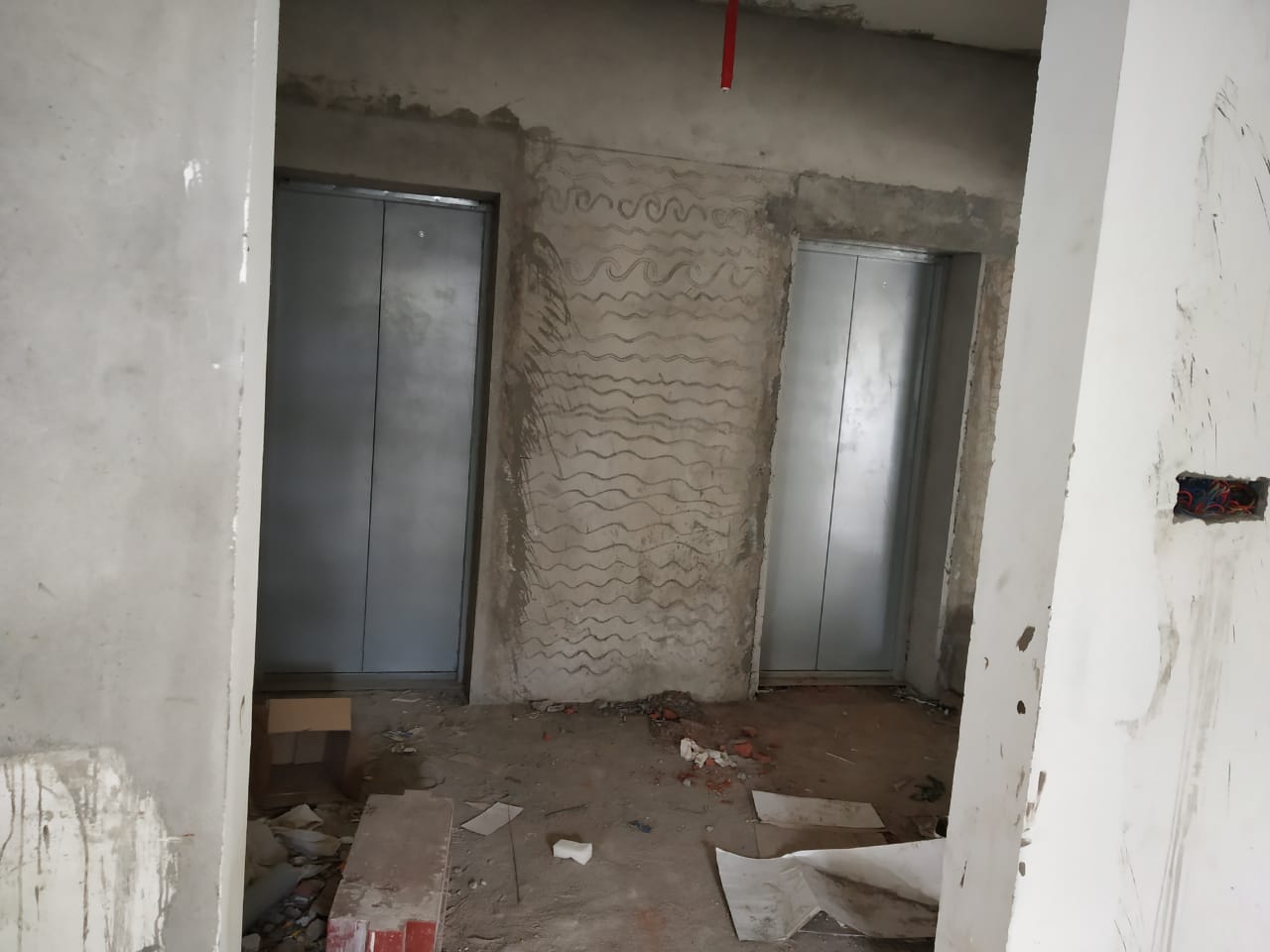

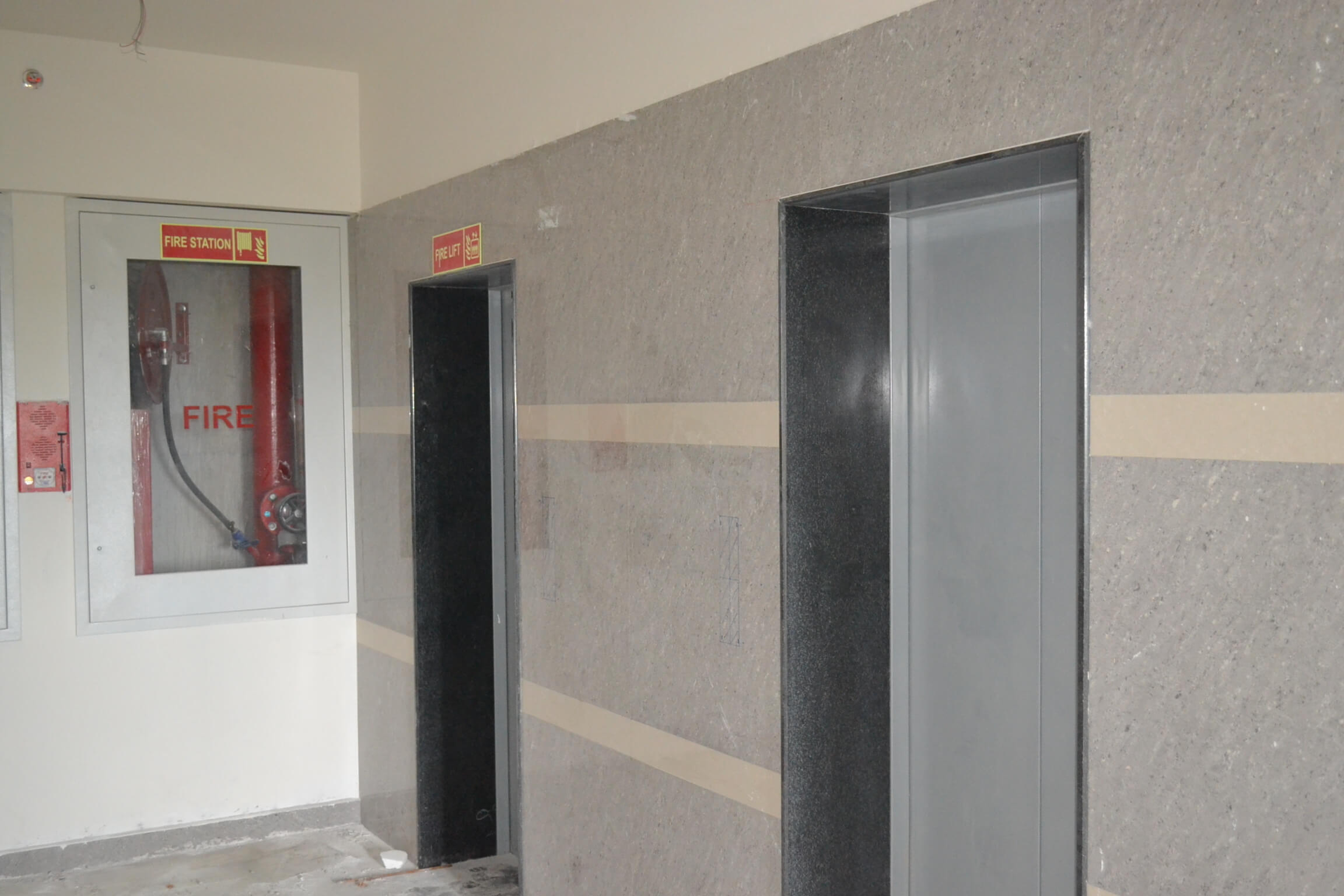

- Lift Work -100% completed
- Staircase and balcony handrails -100% completed

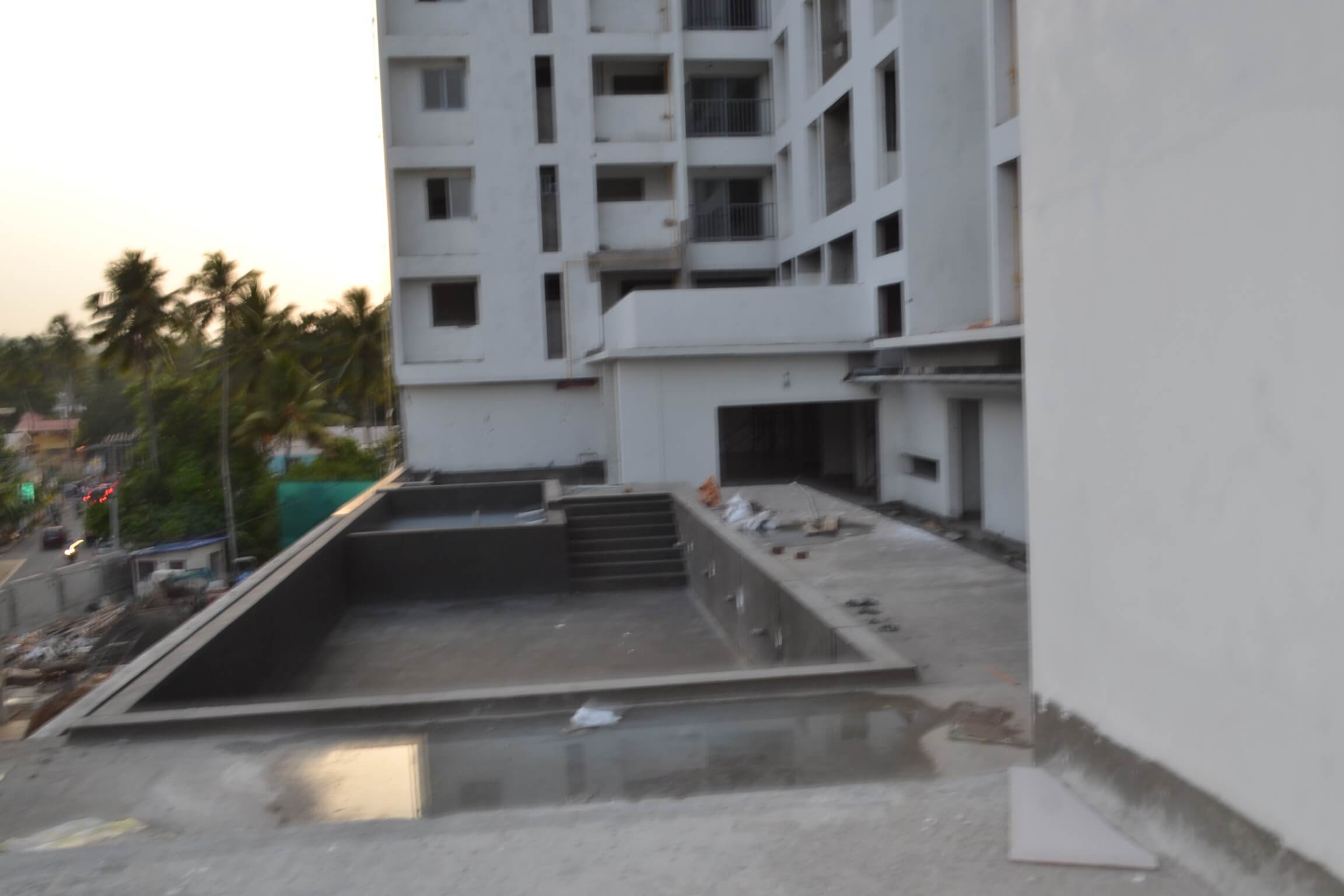

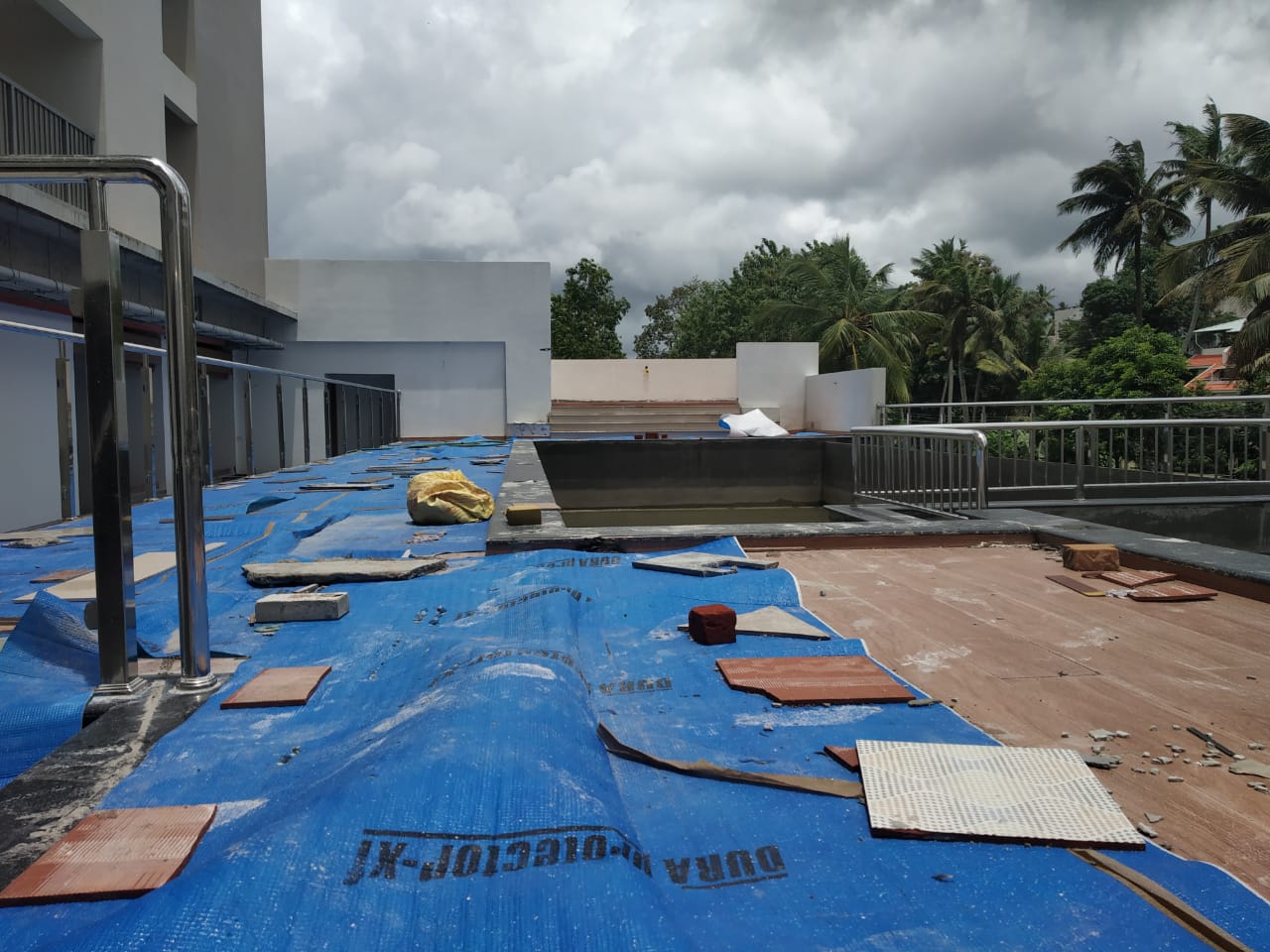

- Swimming pool work -90% completed
- Reticulated gas work-95%completed
As per the current work status from our site we are targeted to complete the following works by end of September 2019
- Wire pulling work -100% to be completed
- DB fixing -115 flats to be completed
- Electrical HT work -100% to be completed
- CP &Sanitary fittings -15(Out of 119) Flats to be completed
- Tiling work -100% to be completed (out of 119)
- Inside Putty work (2nd coat) -110 flats to be completed
- Inside primer work -100flats (out of 119) completed
- External Painting work :West ,North ,East side To be Completed
- Aluminium Fabrication work – 85% to be completed
- Fire Work-100% to be completed

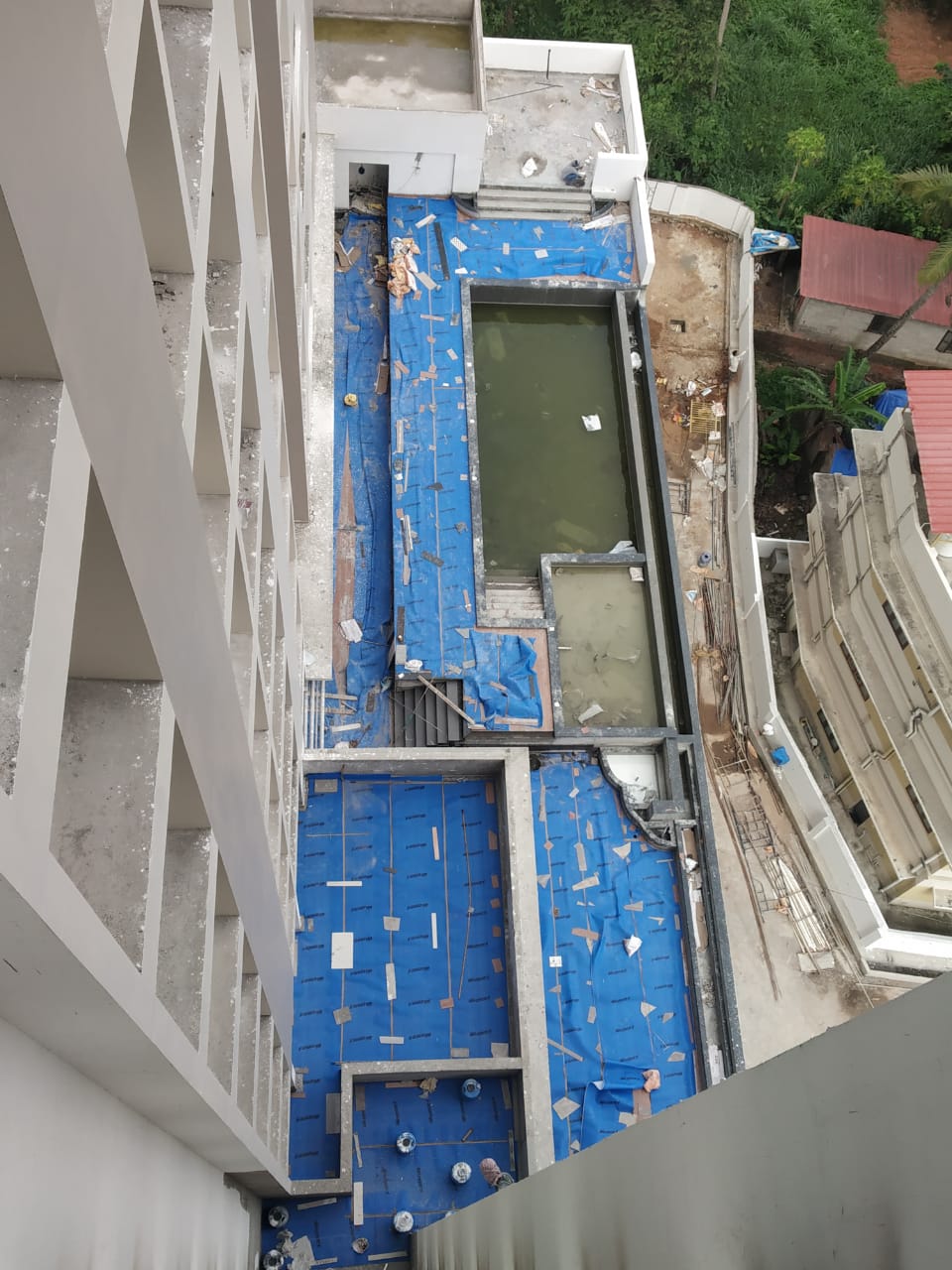

- Swimming pool work -60% to be completed
- Reticulated gas work-100% to be completed
Work status as on 05.09.2019, we have completed the following
- RCC for Structure – 100% completed
- Block/Brick masonry – 100% completed
- Door frame fixing – 100% completed
- Ceiling Plastering work – 100% completed
- Inside wall plastering work – 100% completed
- Wall chasing work – 100% completed
- Wire pulling work -105flats completed
- DB fixing -105 flats completed
- Water Proofing work – 100% completed.
- Electrical HT work -90% completed
- Plumbing work -(internal lines-100% Completed, plumbing work on ground floor and yard- 100% completed
- Tiling work – 105flats completed (out of 119)
- External Plastering work – 100% completed
- Inside Putty work (1 coat) -100% completed
- Inside Putty work (2nd coat) – 100flats(out of 119) completed
- Inside primer work -77 flats (out of 119) completed
- External primer work – 100% completed
- Aluminium Fabrication work -80% completed
- Fire Work-98%completed
- Lift Work -100% completed
- Staircase and balcony handrails -100% completed
- Swimming pool work -50% completed (water proofing completed ,plumbing work in progress )
- Reticulated gas work-85%completed
As per the current work status from our site we are targeted to complete the following works by end of August 2019
- Wire pulling work -115 flats to be completed
- DB fixing -115 flats to be completed
- Electrical HT work -100% to be completed
- Plumbing work -plumbing work on ground floor and yard -100% completed
- Tiling work -115apts to be completed (out of 119)
- Inside Putty work (2nd coat) -95 flats to be completed
- Inside primer work -80flats (out of 119) completed
- Aluminium Fabrication work – 85% to be completed
- Fire Work-100% to be completed

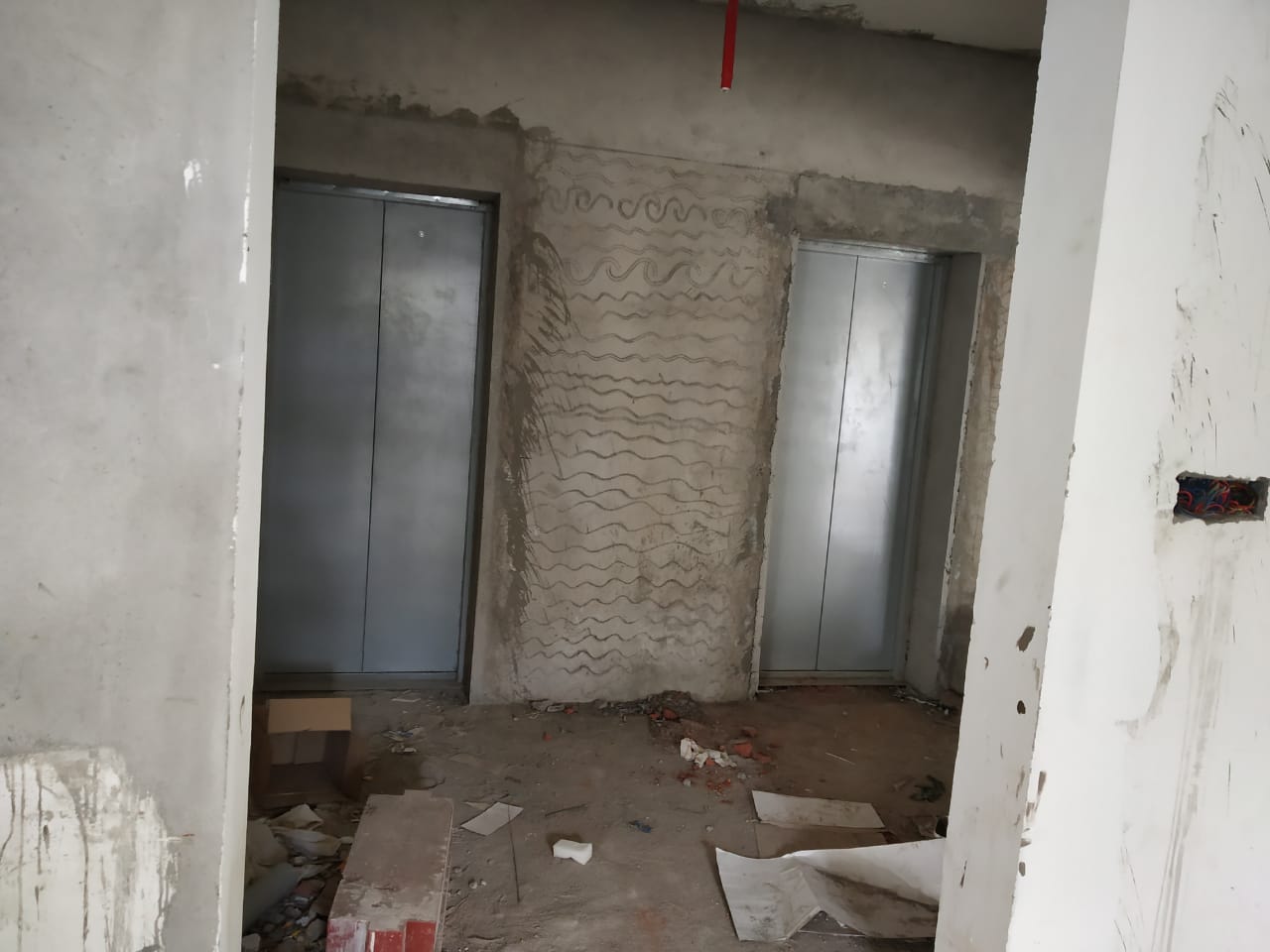

- Lift Work -4 th lift work -100% to be completed
- Swimming pool work -60% to be completed
- Reticulated gas work-100% to be completed
Work status as on 05.08.2019, we have completed the following
- RCC for Structure – 100% completed
- Block/Brick masonry – 100% completed
- Door frame fixing – 100% completed
- Ceiling Plastering work – 100% completed
- Inside wall plastering work – 100% completed
- Wall chasing work – 100% completed
- Wire pulling work -100 flats completed
- DB fixing -100 flats completed
- Water Proofing work – 100% completed.
- Electrical HT work -90% completed
- Plumbing work -(internal lines-100% Completed, plumbing work on ground floor and yard -95% completed
- Tiling work – 103flats completed (out of 119)
- External Plastering work – 100% completed
- Inside Putty work (1 coat) -100% completed
- Inside Putty work (2nd coat) – 84flats(out of 119) completed
- Inside primer work -66 flats (out of 119) completed
- External primer work – 100% completed
- Aluminium Fabrication work -80% completed
- Fire Work-98%completed
- Lift Work -3 out of 4 completed,4 th lift in progress.
- Staircase and balcony handrails -100% completed
- boundary wall,security cabin -100% completed.
- Swimming pool work -50% completed (water proofing completed ,plumbing work in progress )
- Reticulated gas work-85%completed
As per the current work status from our site we are targeted to complete the following works by end of July 2019
- Wire pulling work -110 flats to be completed
- DB fixing -1105to be completed
- Electrical HT work -100% to be completed
- Plumbing work -plumbing work on ground floor and yard -100% completed
- Tiling work -115apts to be completed (out of 118)
- Inside Putty work (2nd coat) -80% to be completed
- Aluminium Fabrication work – 85% to be completed
- Fire Work-100% to be completed
- Lift Work -4 th lift work -100% to be completed,

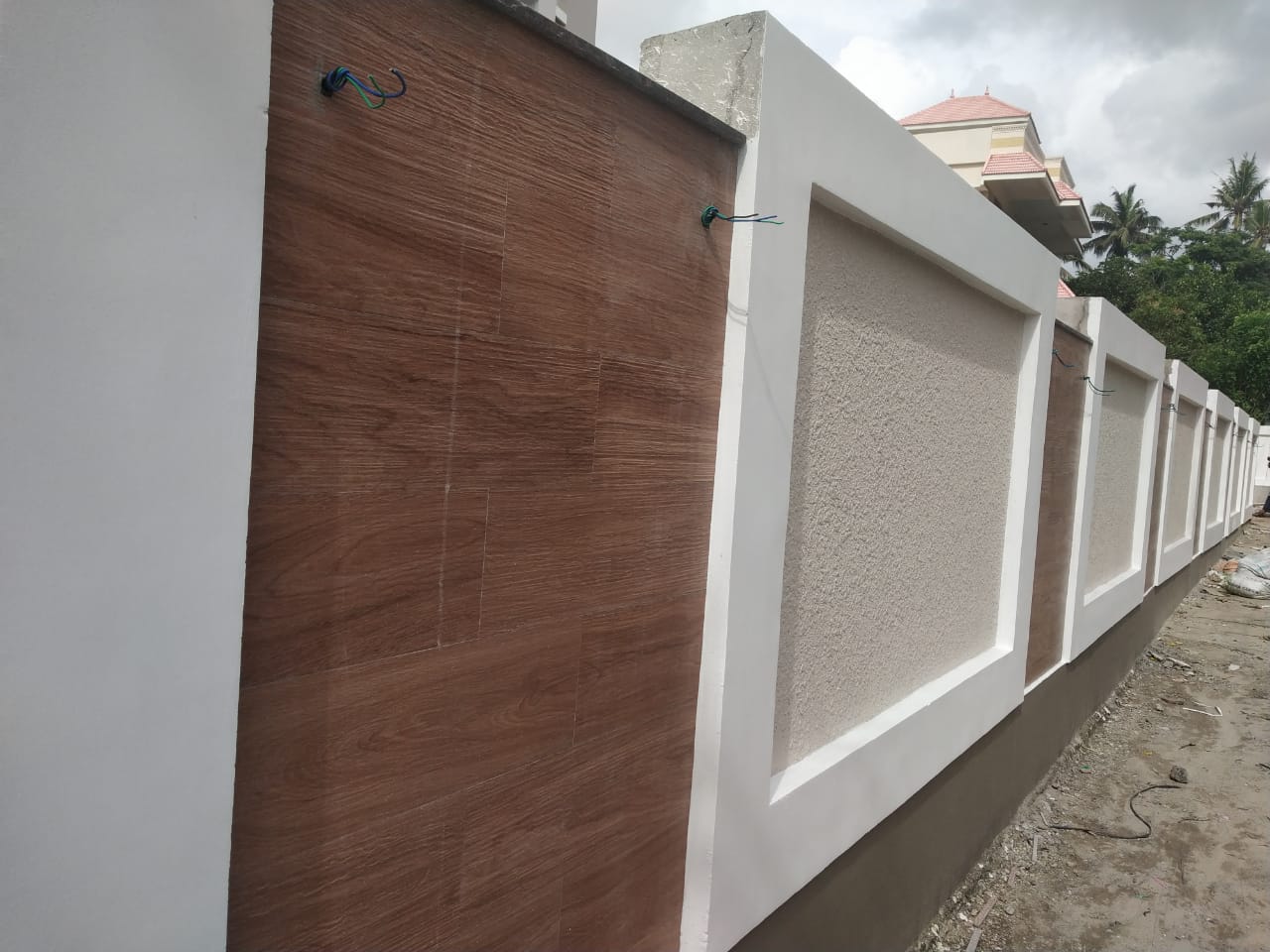

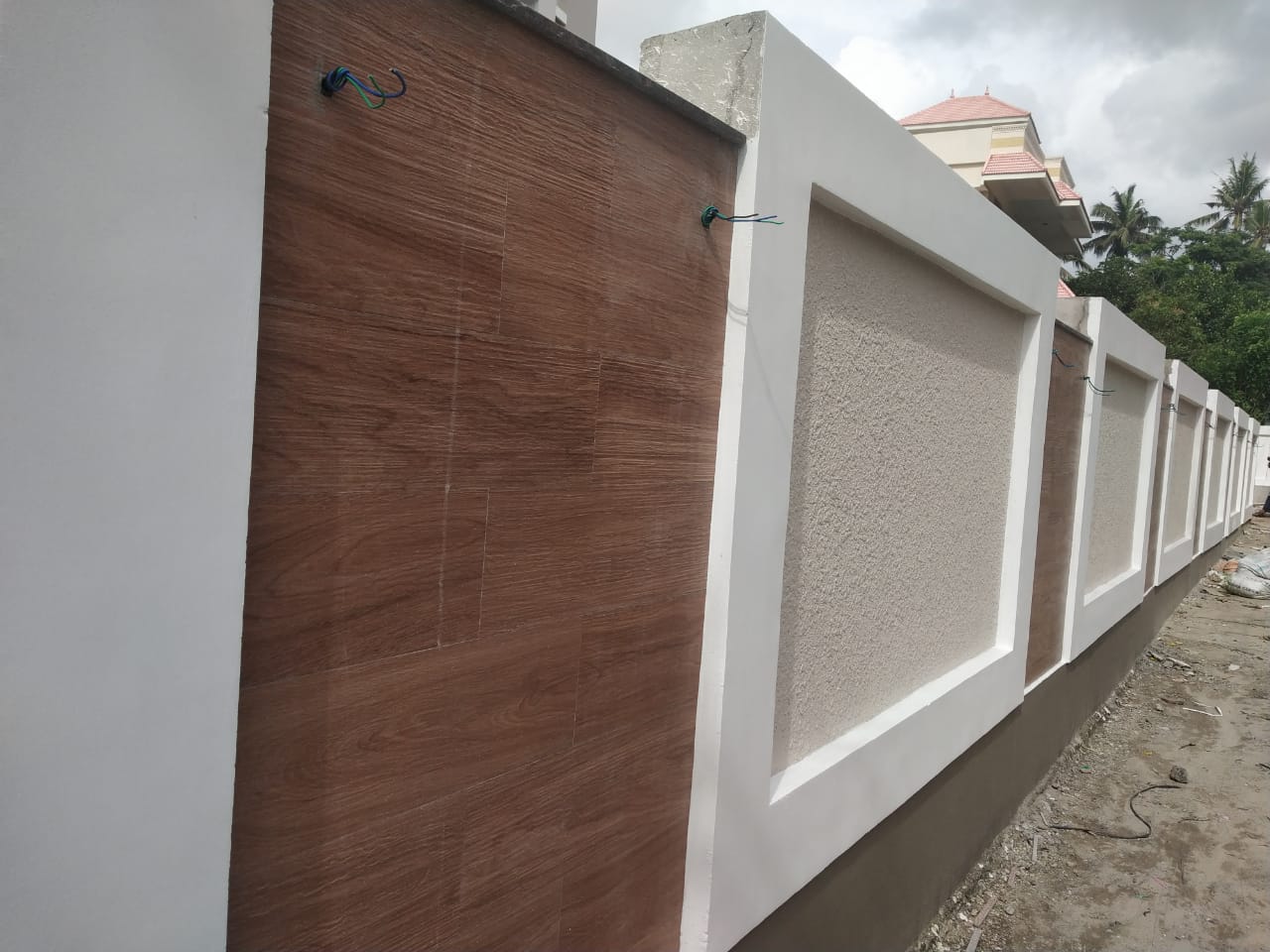

- Front gate work and boundary wall work -100% to be completed
- Swimming pool work -60% to be completed
- Reticulated gas work-85%completed
Work status as on 06.07.2019, we have completed the following
- RCC for Structure – 100% completed
- Block/Brick masonry – 100% completed
- Door frame fixing – 100% completed
- Ceiling Plastering work – 100% completed
- Inside wall plastering work – 100% completed
- Wall chasing work – 100% completed
- Wire pulling work -100 flats completed
- DB fixing -100 completed
- Water Proofing work – 100% completed,terrace area-100%completed
- Electrical HT work -80% completed
- Plumbing work -(internal lines-100% Completed, plumbing work on ground floor and yard -50% completed
- Tiling work – 100flats completed (out of 118)
- External Plastering work – 100% completed
- Inside Putty work (1 coat) -100% completed
- Inside Putty work (2nd coat) – 65% completed
- External primer work – 95% completed
- Aluminium Fabrication work -80% completed
- Fire Work-95%completed
- Lift Work -2 out of 4 completed,3 rd lift work -75% completed
- Staircase and balcony handrails -100% completed
- boundary wall,security cabin -100% completed.
- Swimming pool work -50% completed.
- Reticulated gas work-70%completed
As per the current work status from our site we are targeted to complete the following works by end of June 2019
- Wire pulling work -110 flats to be completed
- DB fixing -110 to be completed
- Electrical HT work -100% to be completed
- Tiling work -105apts to be completed (out of 118)
- Inside Putty work (2nd coat) -65% to be completed
- Aluminium Fabrication work – 90% to be completed
- Fire Work-100% to be completed
- Lift Work -3rd lift work -100% to be completed,4th lift work -100% to be completed,
- Front gate work and boundary wall work -100% to be completed
- Swimming pool work -60% to be completed
- Reticulated gas work-80%completed
Work status as on 06.06.2019, we have completed the following
- RCC for Structure – 100% completed
- Block/Brick masonry – 100% completed
- Door frame fixing – 100% completed
- Ceiling Plastering work – 100% completed
- Inside wall plastering work – 100% completed
- Wall chasing work – 100% completed
- Wire pulling work -95 flats completed
- DB fixing -95 completed
- Water Proofing work – 100% completed,terrace area-100%completed
- Electrical HT work -80% completed
- Plumbing work -(internal lines)100% ,duct lines(100%)completed, plumbing work on ground floor and yard on progress
- Tiling work – 95flats completed (out of 118)
- External Plastering work – 95% completed
- Inside Putty work (1 coat) -100% completed
- Inside Putty work (2nd coat) – 50% completed
- External primer work – 95% completed
- Aluminium Fabrication work -75% completed
- Fire Work-95%completed
- Lift Work -50% completed(2 out of 4 completed),3 rd lift work -75% completed
- Staircase and balcony handrails -100% completed
- boundary wall,security cabin -100% completed.
- Swimming pool work -water proofing work completed ( overall 50% completed)
- Reticulated gas work-60%completed
As per the current work status from our site we are targeted to complete the following works by end of May 2019
- Wire pulling work -100 flats to be completed
- DB fixing -100% to be completed
- Tiling work -105apts to be completed (out of 118)
- Inside Putty work (2nd coat) -65% to be completed
- Aluminium Fabrication work – 70% to be completed
- Lift Work -75% to be completed
- Front gate work and boundary wall work -100% to be completed
- Swimming pool work -60% to be completed
- Reticulated gas work-70%completed
Work status as on 06.05.2019, we have completed the following
- RCC for Structure – 100% completed
- Block/Brick masonry – 100% completed
- Door frame fixing – 100% completed
- Ceiling Plastering work – 100% completed
- Inside wall plastering work – 100% completed
- Wall chasing work – 100% completed
- Wire pulling work -87 flats completed
- DB fixing -95% completed
- Water Proofing work – 100% completed,terrace area-100%completed
- Electrical HT work -77% completed
- Plumbing work -(internal lines)100% ,duct lines(100%)completed, plumbing work on ground floor and yard on progress
- Tiling work – 95flats completed (out of 118)
- External Plastering work – 95% completed
- Inside Putty work (1 coat) -100% completed
- Inside Putty work (2nd coat) – 50% completed
- External primer work – 95% completed
- Aluminium Fabrication work -65% completed
- Fire Work-95%completed
- Lift Work -50% completed(2 out of 4 completed),3 rd lift work on progress
- Staircase and balcony handrails -100% completed
- Front gate work,boundary wall -on progress
- Swimming pool work -water proofing work completed ( overall 30% completed)
- Reticulated gas work-60%completed
As per the current work status from our site we are targeted to complete the following works by end of April 2019
- Wire pulling work -100 flats to be completed
- DB fixing -100% to be completed
- Electrical HT work – 85 % to be completed
- Plumbing work -duct lines100% to be completed.
- Tiling work -94 apts to be completed (out of 118)
- External Plastering work – 100% completed
- Inside Putty work (1 coat) – 100% to be completed
- Inside Putty work (2nd coat) -65% to be completed
- Aluminium Fabrication work – 70% to be completed
- Lift Work -75% to be completed
- Retaining wall – 100% to be completed
Work status as on 05.04.2019, we have completed the following
- RCC for Structure – 100% completed
- Block/Brick masonry – 100% completed
- Door frame fixing – 100% completed
- Ceiling Plastering work – 100% completed
- Inside wall plastering work – 100% completed
- Wall chasing work – 100% completed
- Wire pulling work -87 flats completed

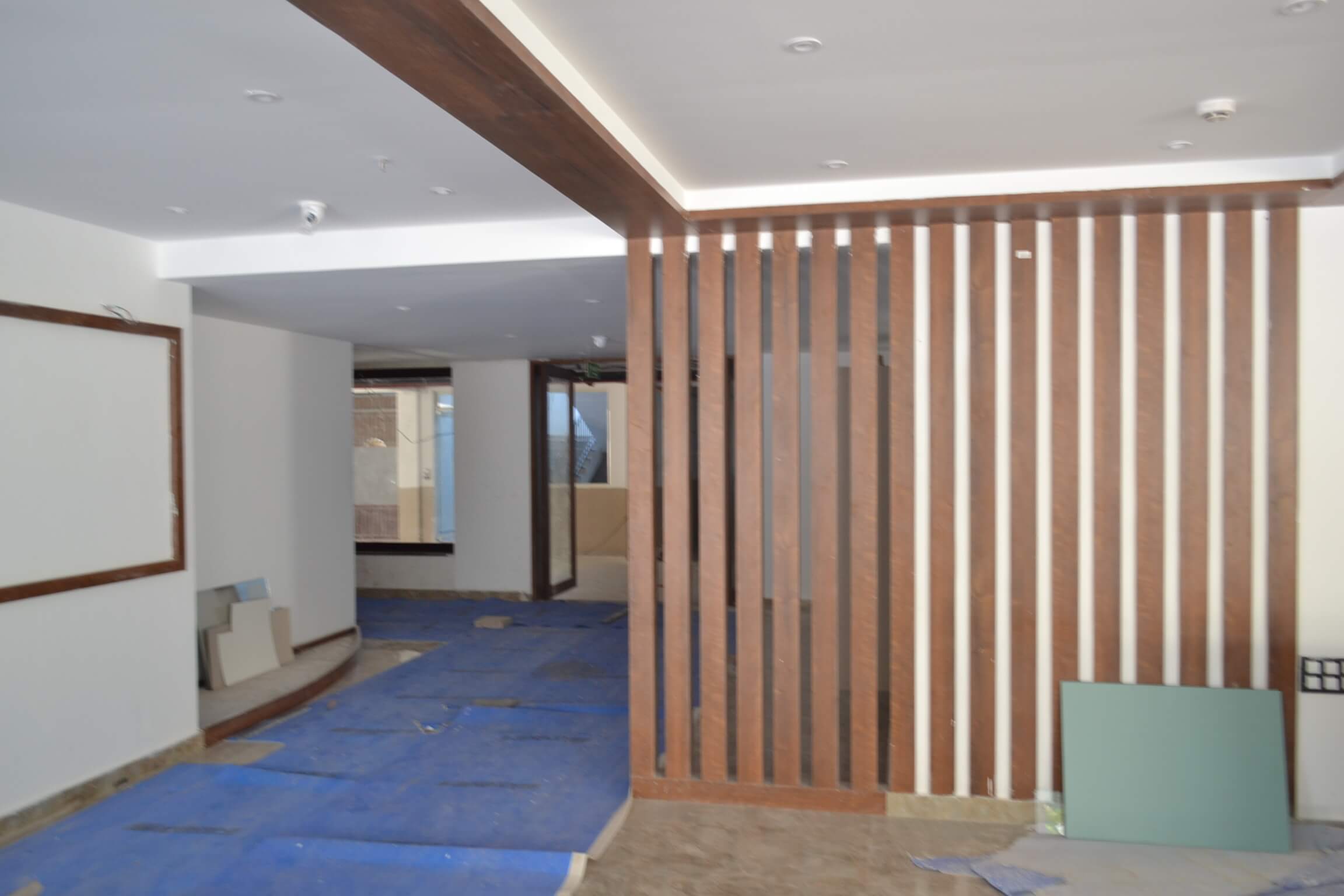

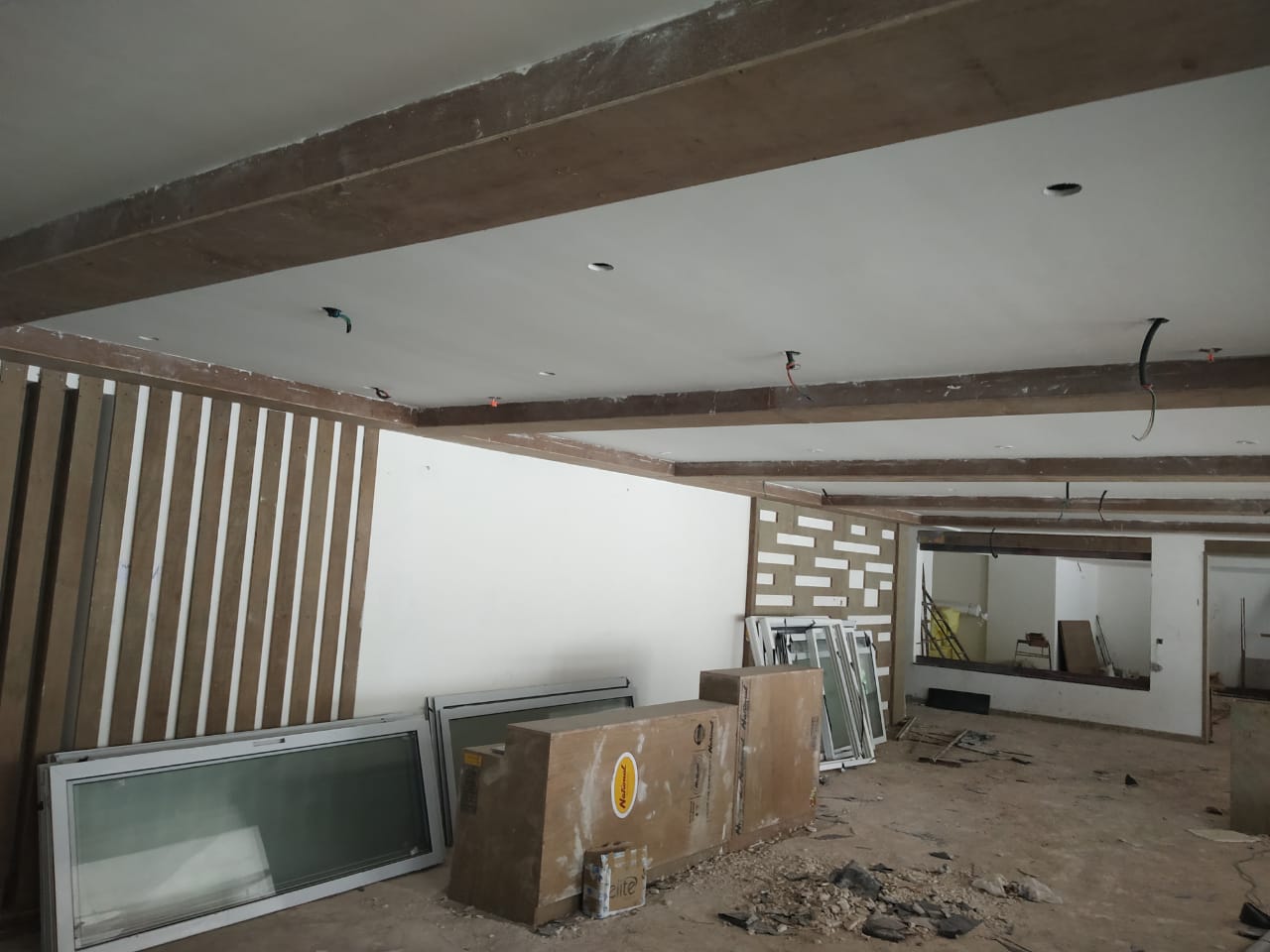

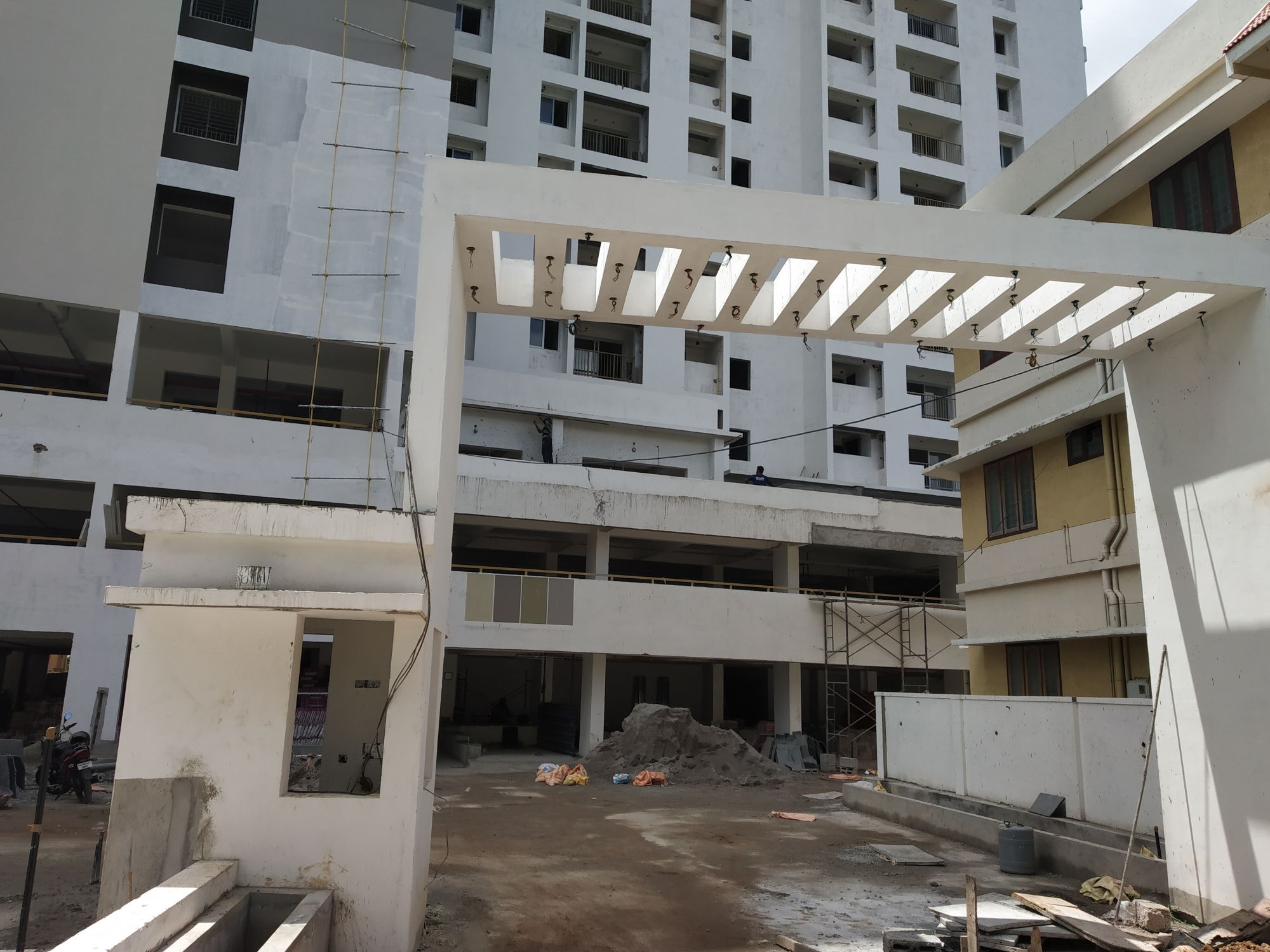

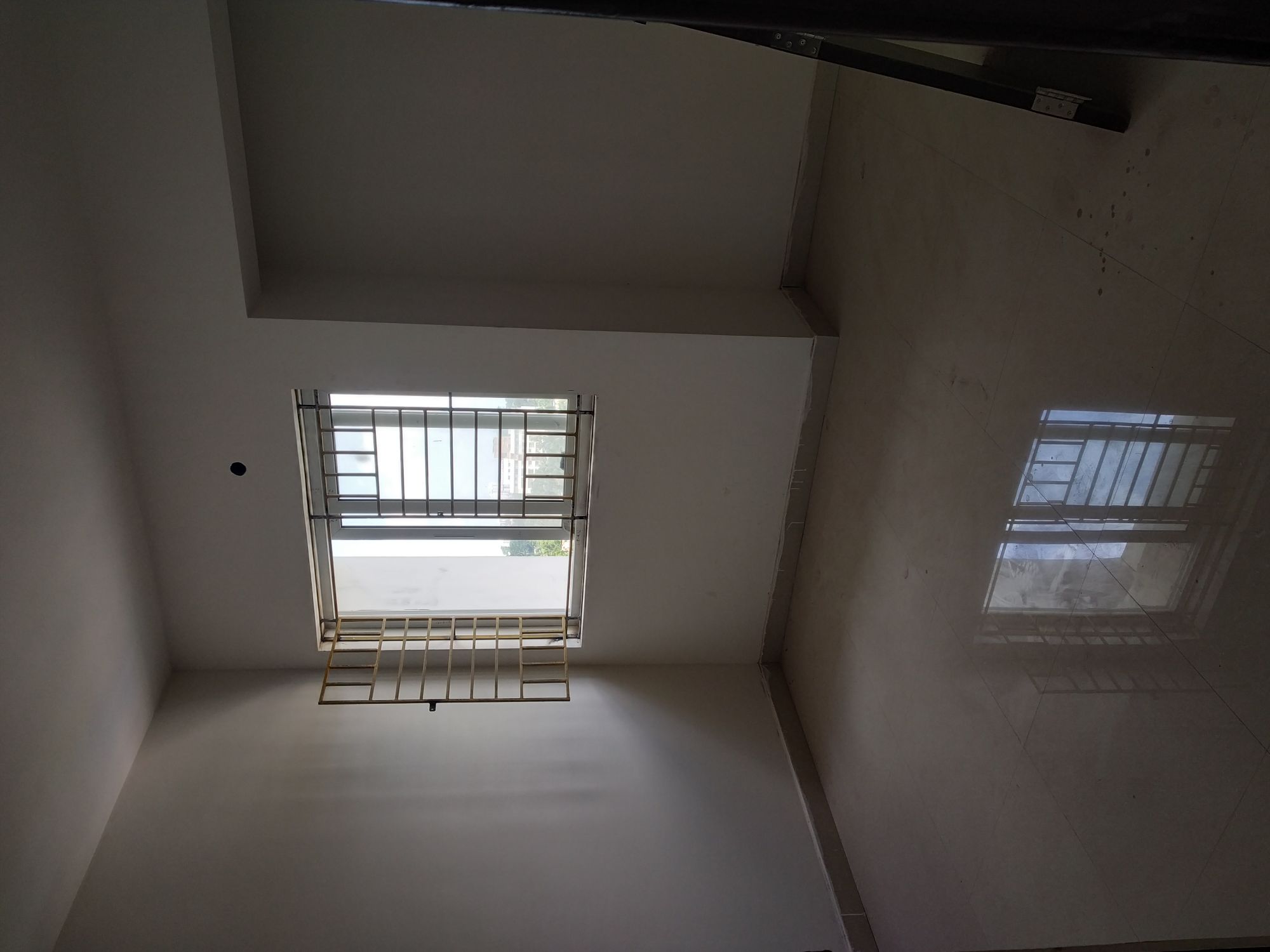

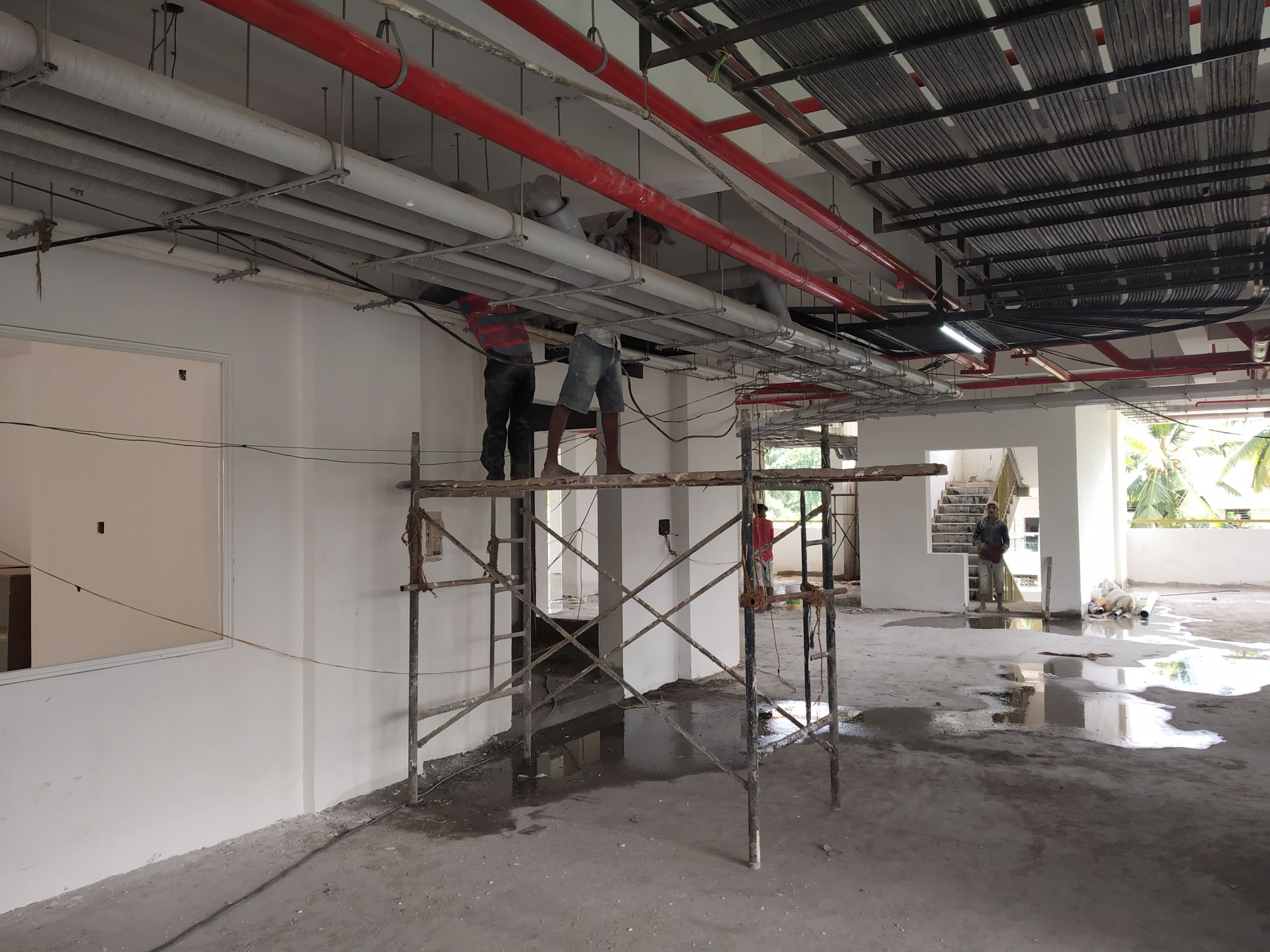

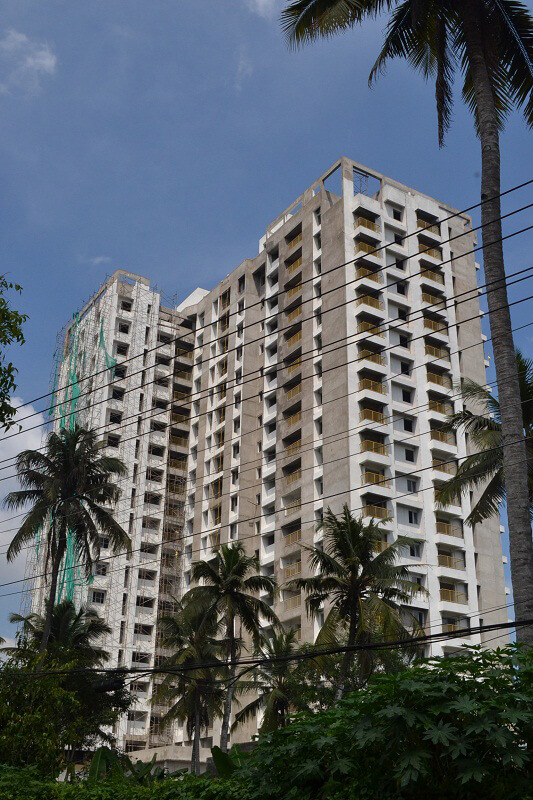

- DB fixing -95% completed

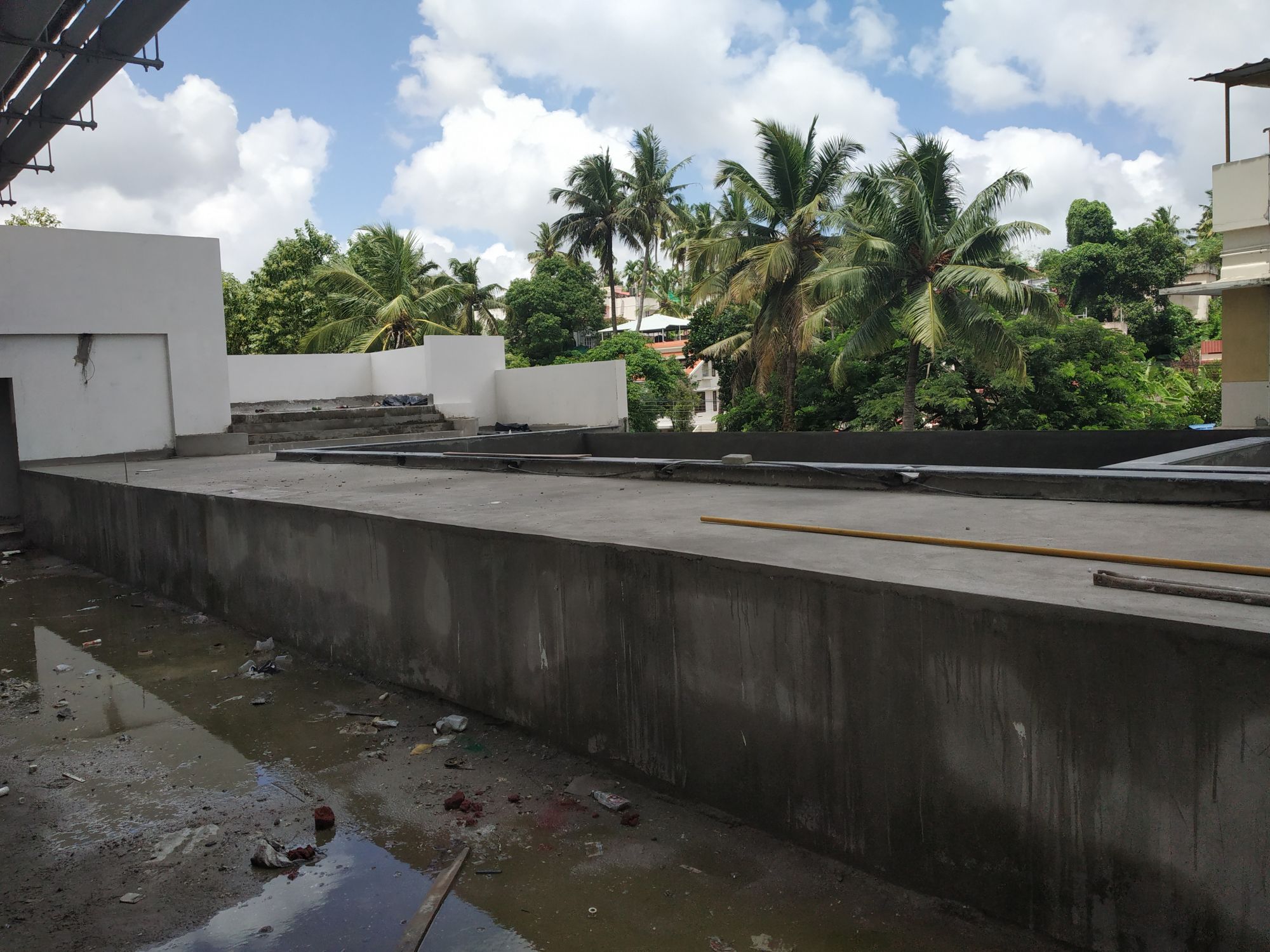

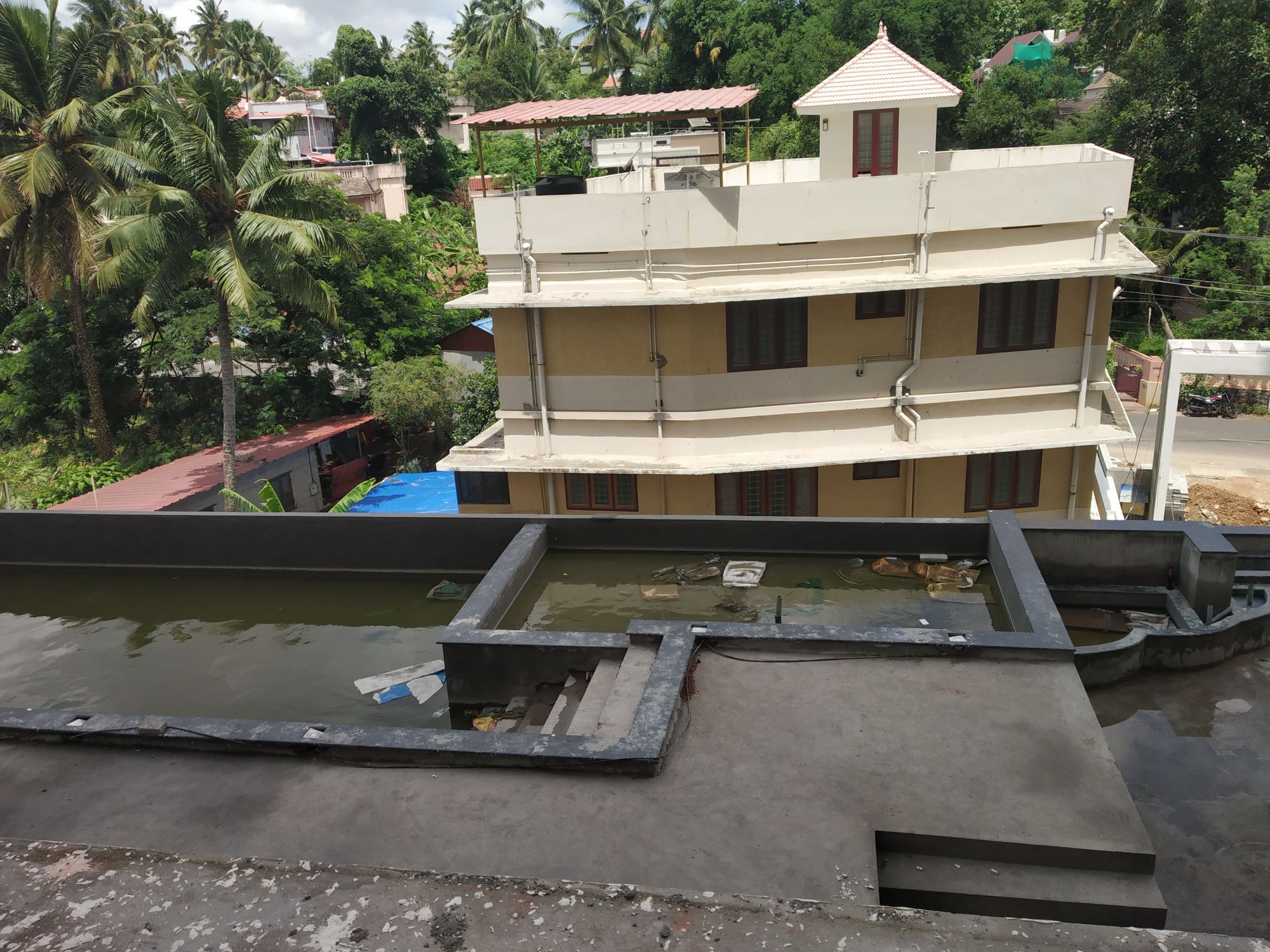

- Water Proofing work – 100% completed,terrace area-100%completed

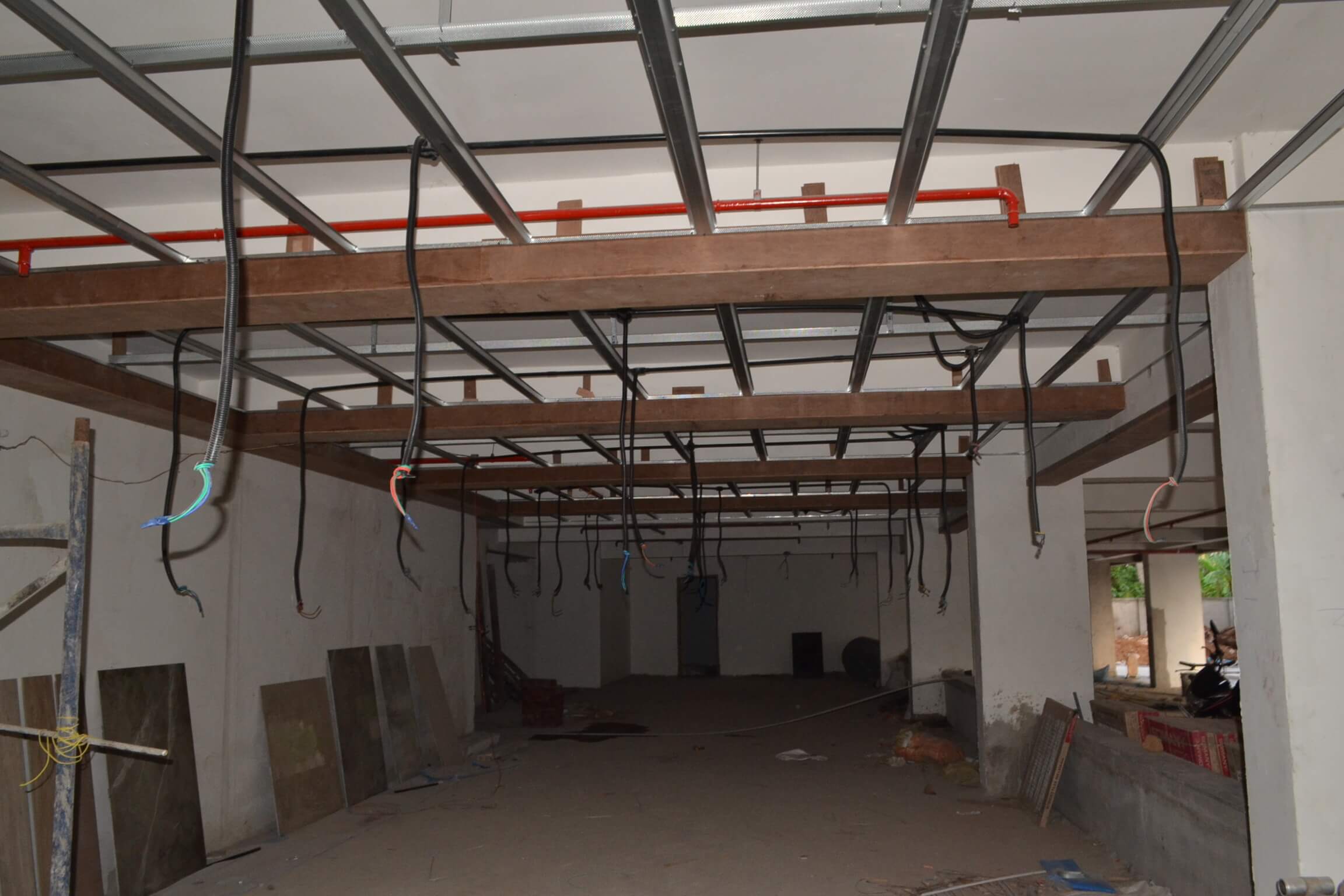

- Electrical HT work -75 % completed
- Plumbing work -(internal lines)100% ,duct lines(90%)completed.

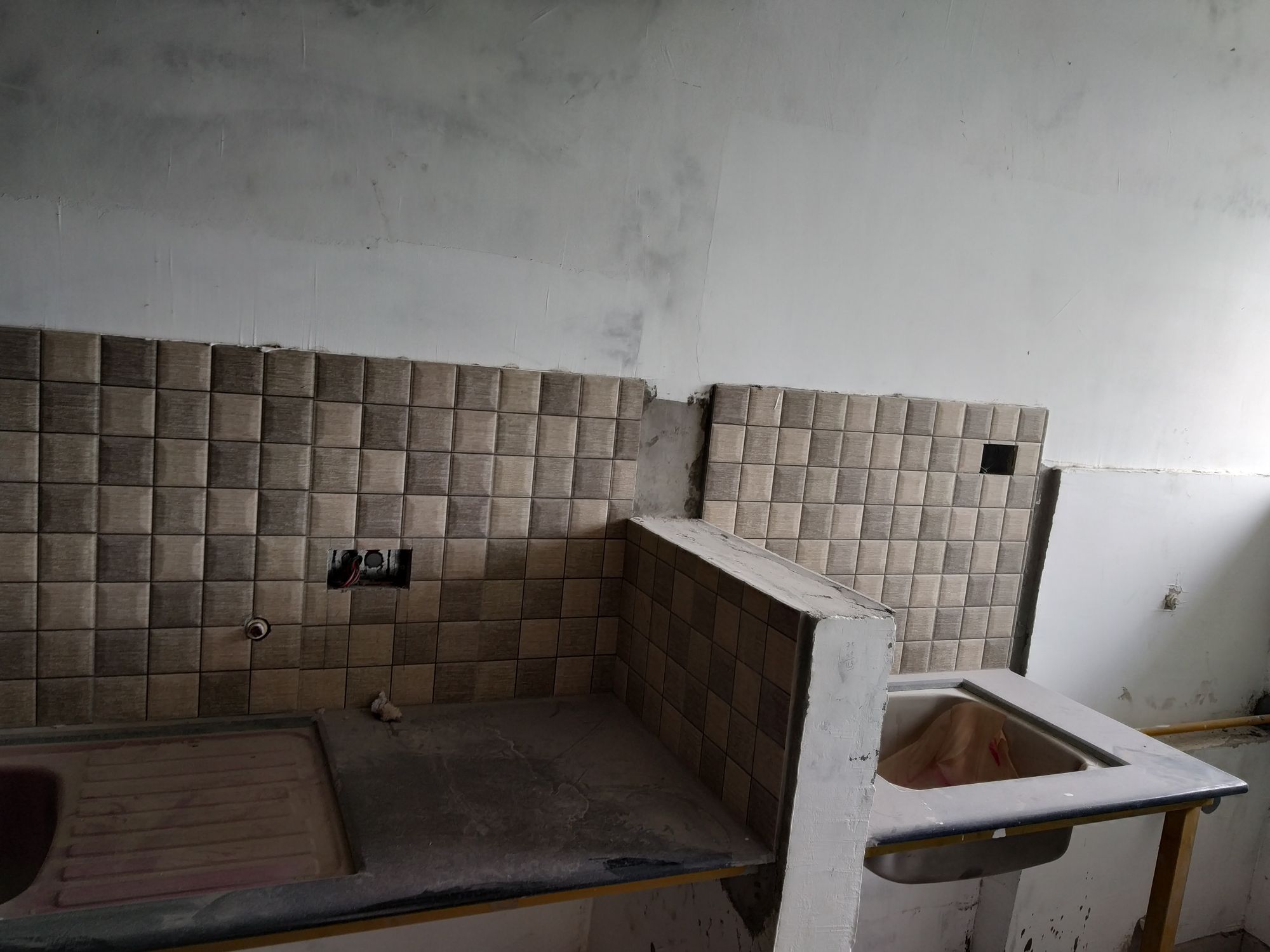

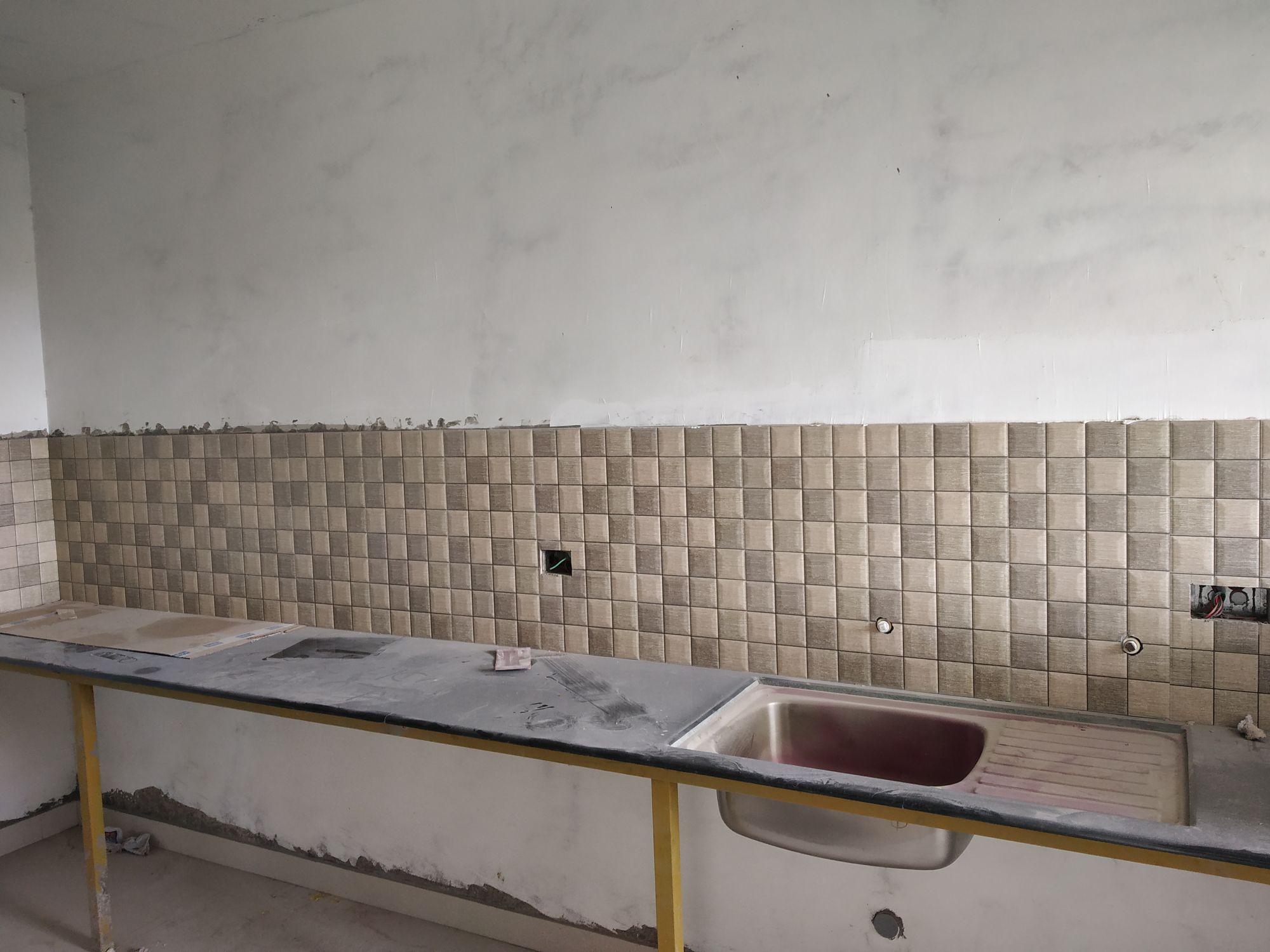

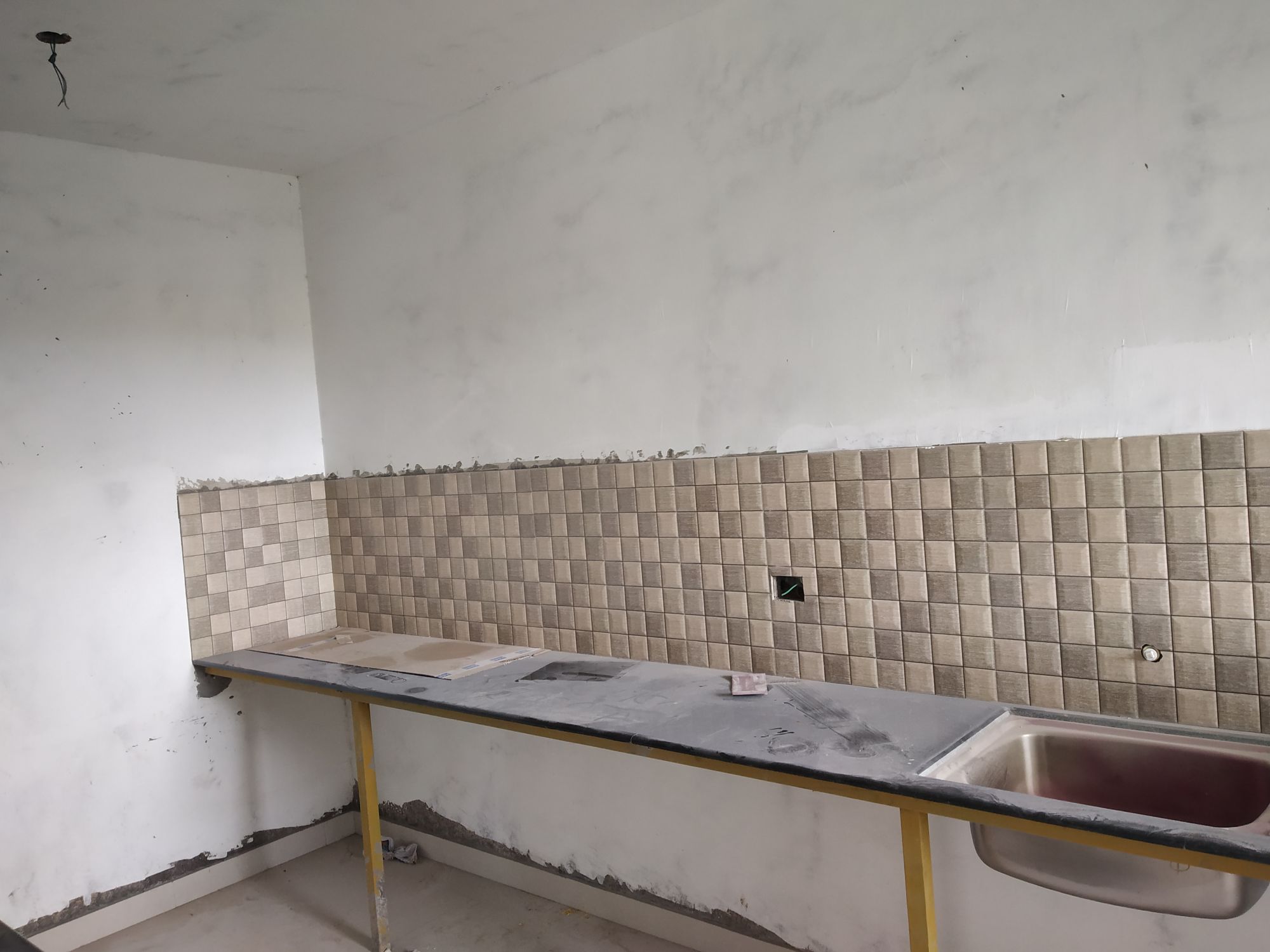

- Tiling work – 80flats completed (out of 118)

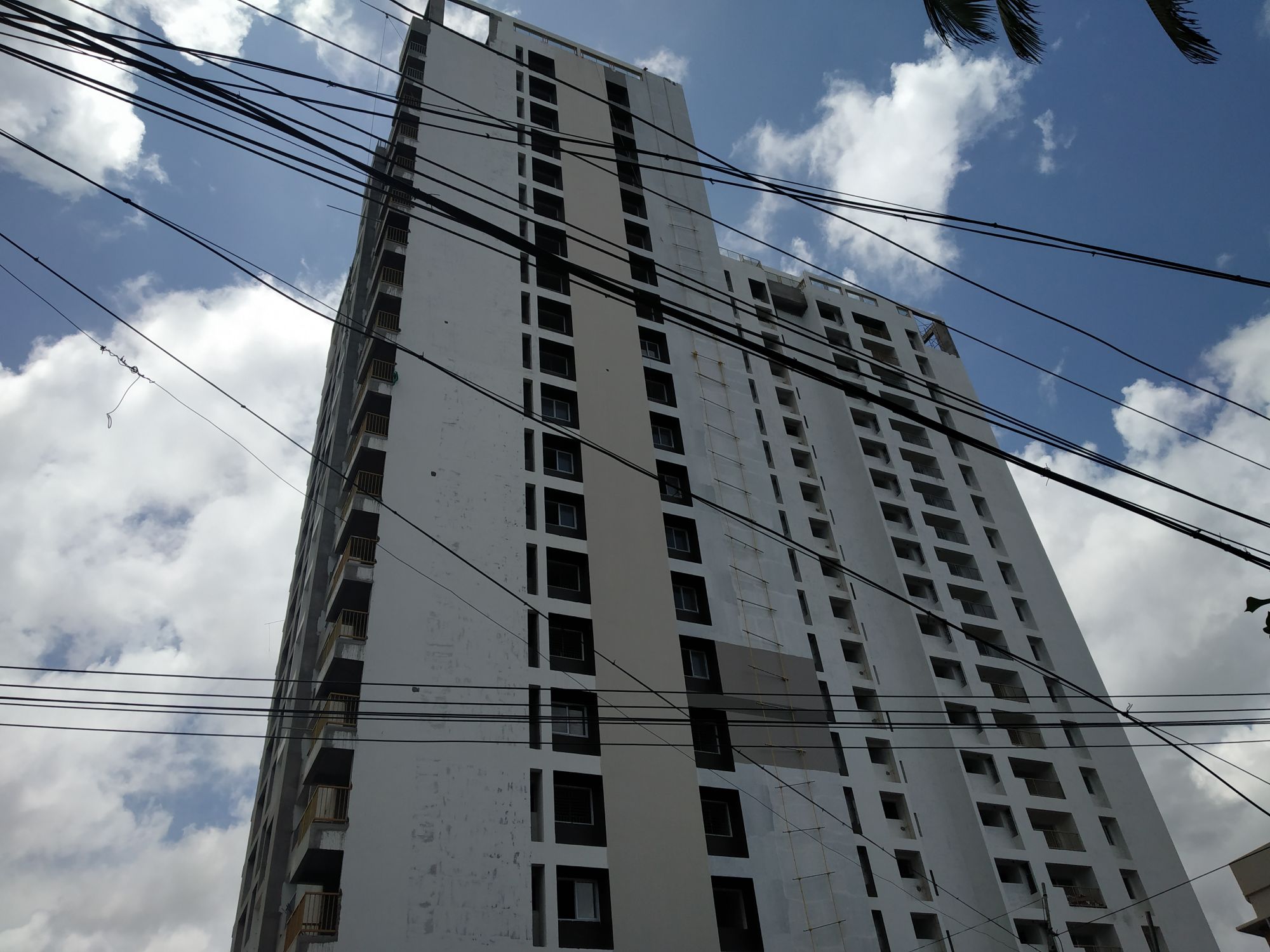

- External Plastering work – 95% completed

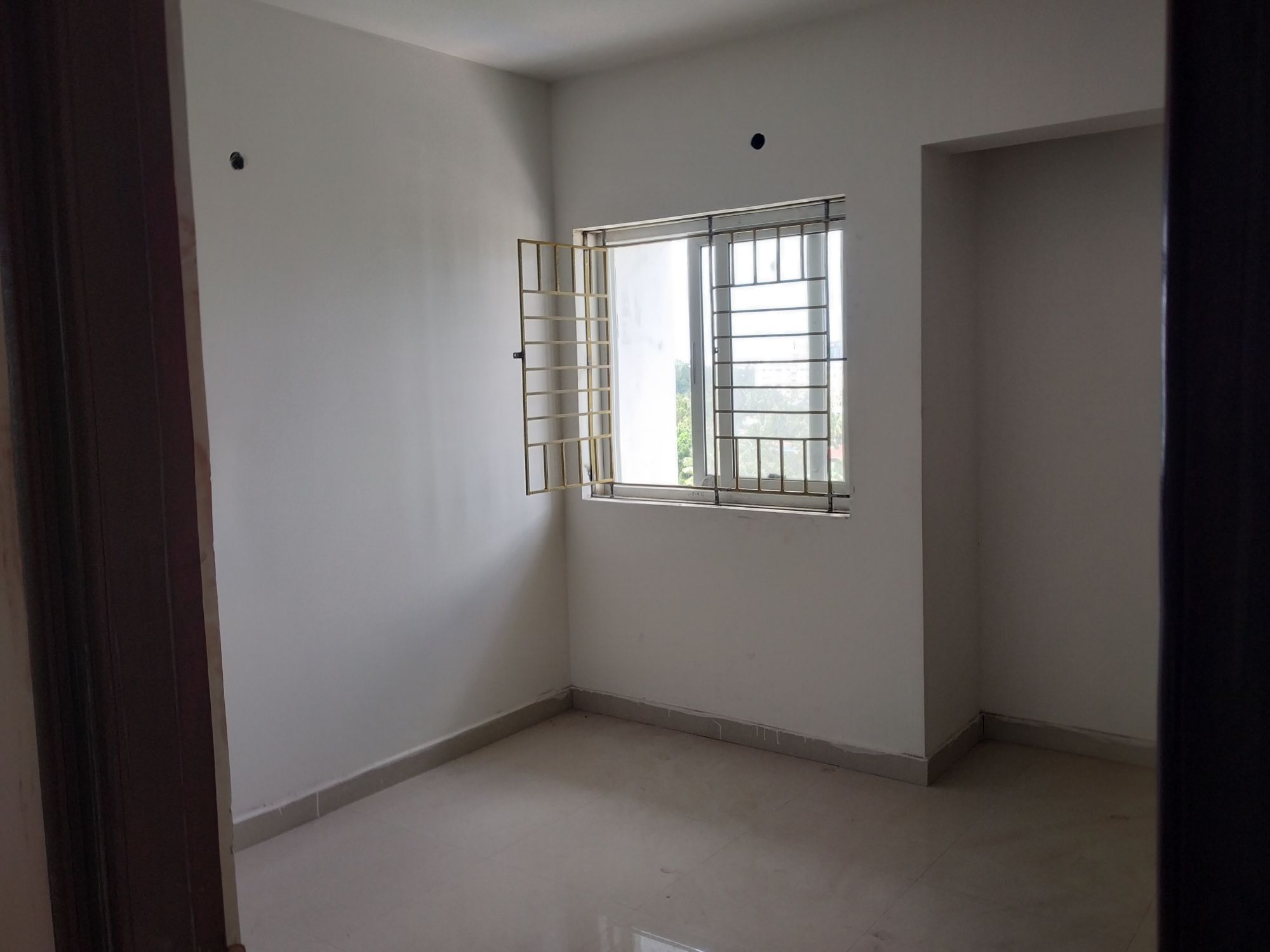

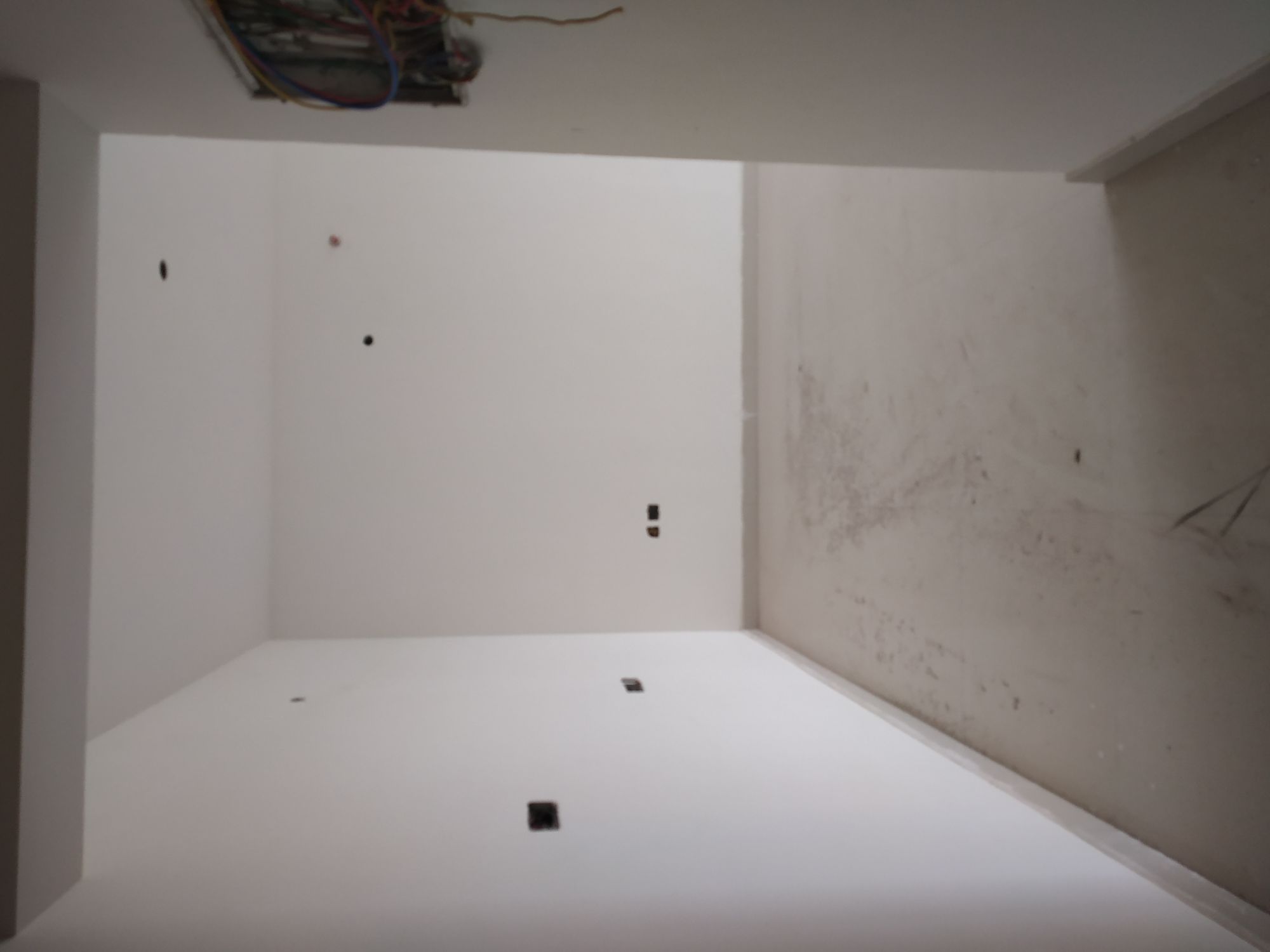

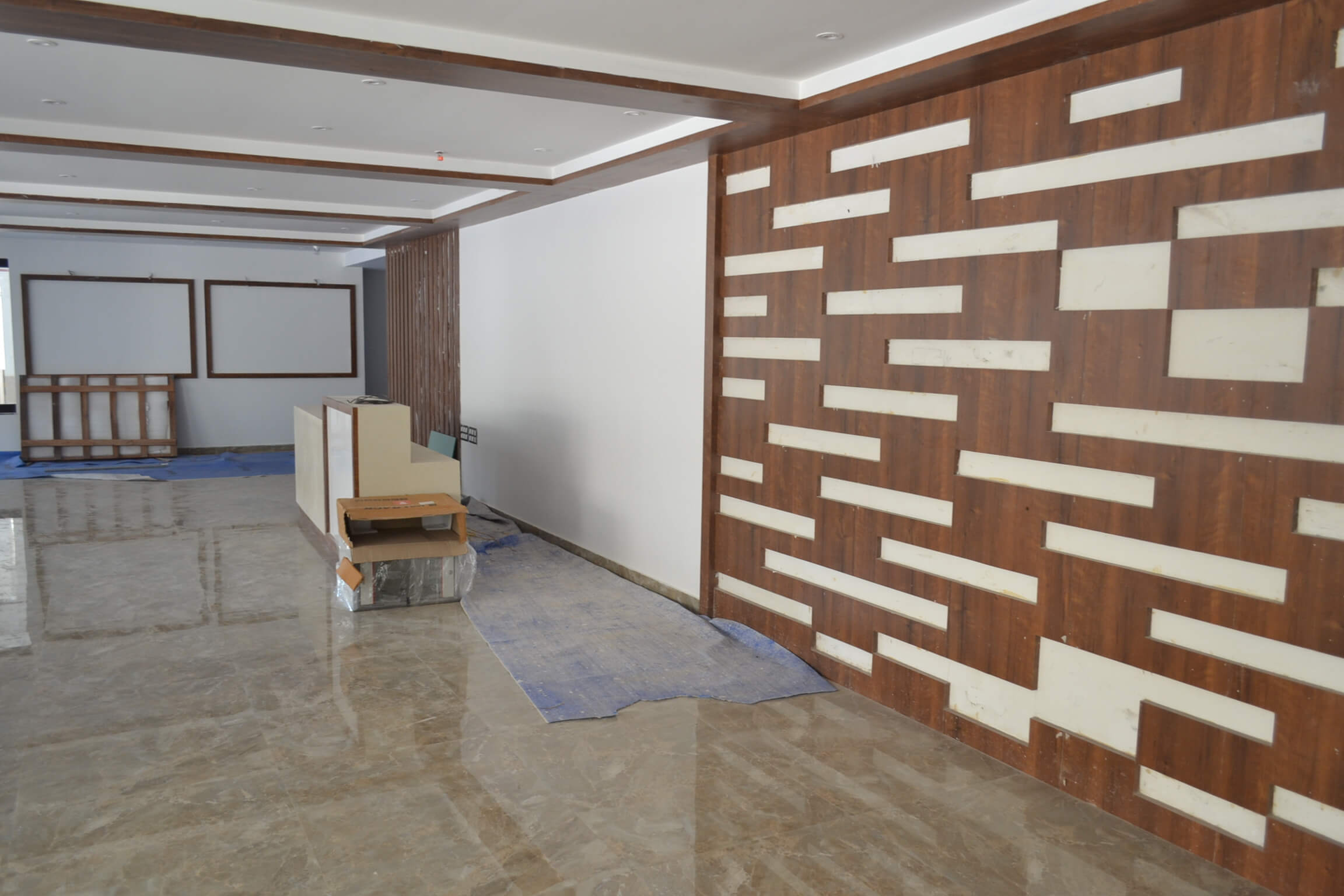

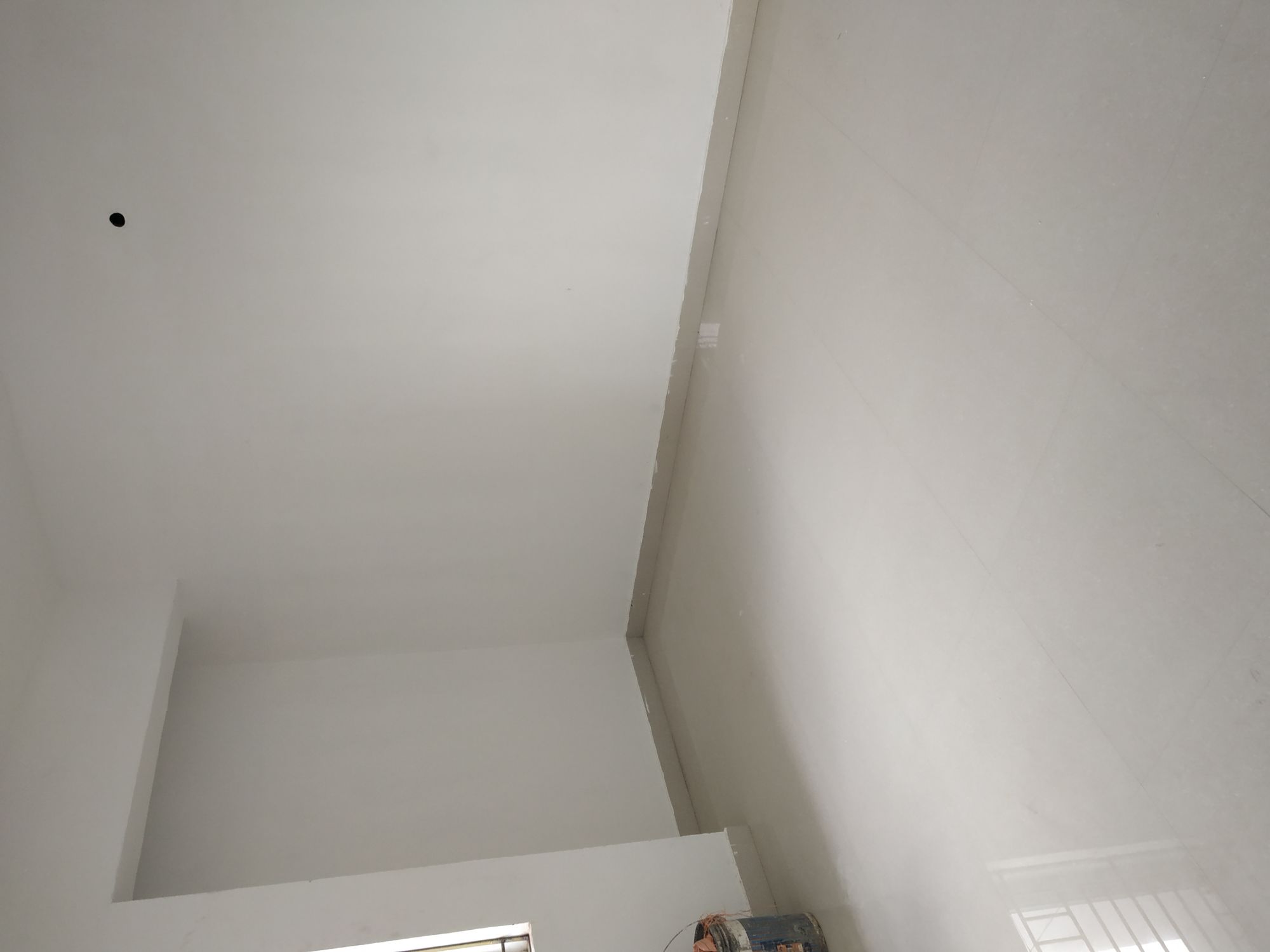

- Inside Putty work (1 coat) -95% completed
- Inside Putty work (2nd coat) – 50% completed
- External primer work – 95% completed

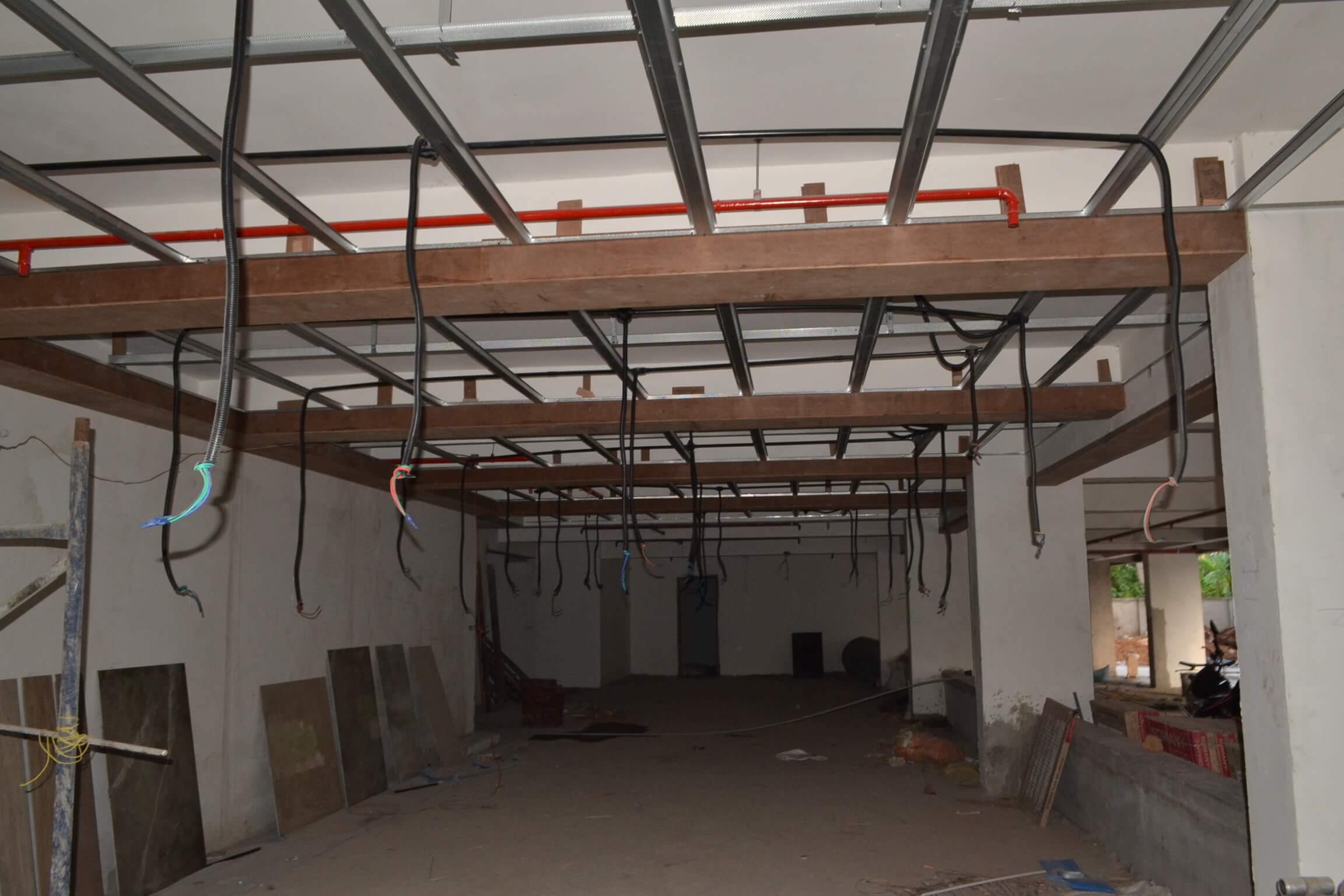

- Aluminium Fabrication work -65% completed
- Fire Work-100%completed
- Lift Work -50% completed
- Reticulated gas work-100%completed
As per the current work status from our site we are targeted to complete the following works by end of March 2019
- Wire pulling work -100 flats to be completed
- DB fixing -100% to be completed
- Electrical HT work – 85 % to be completed
- Plumbing work -duct lines 100% to be completed.
- Tiling work -88 apts to be completed (out of 118)
- External Plastering work – 100% completed
- Inside Putty work (1 coat) – 100% to be completed
- Inside Putty work (2nd coat) – 50% to be completed
- Aluminium Fabrication work – 70% to be completed
- Lift Work -60% to be completed

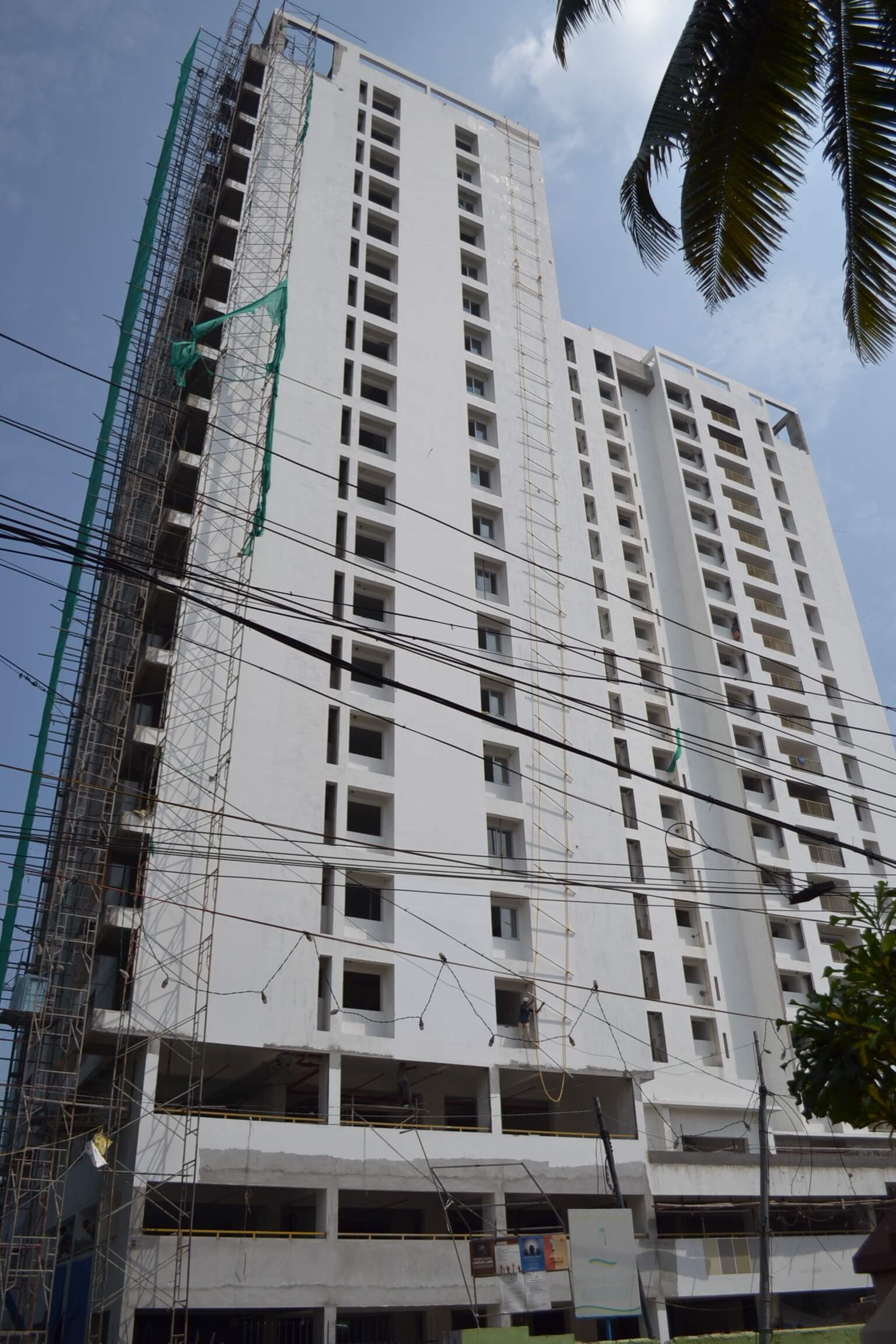

Work status as on 06-03-2019, we have completed the following

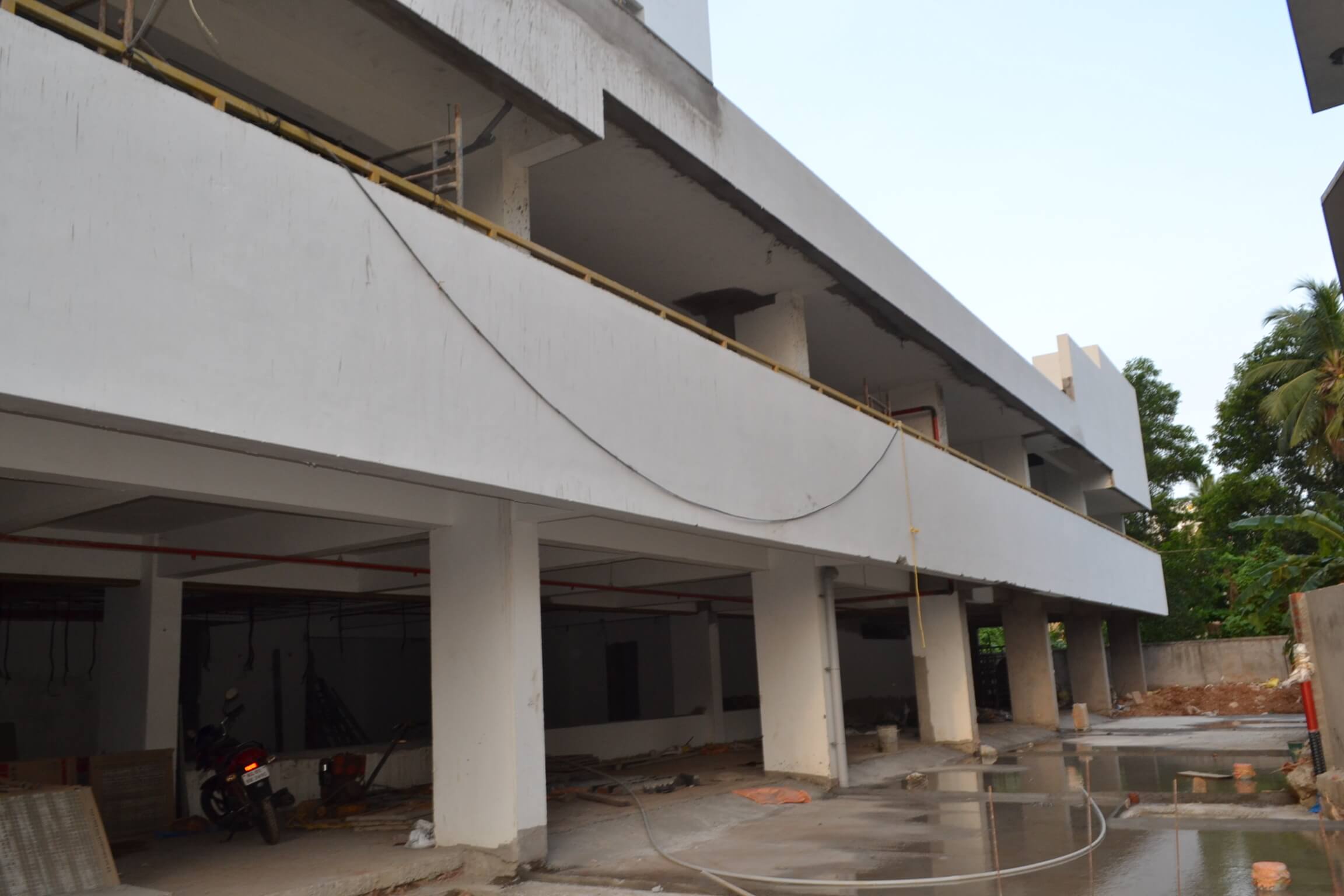

- RCC for Structure – 100% completed
- Block/Brick masonry – 100% completed
- Door frame fixing – 100% completed
- Ceiling Plastering work – 100% completed

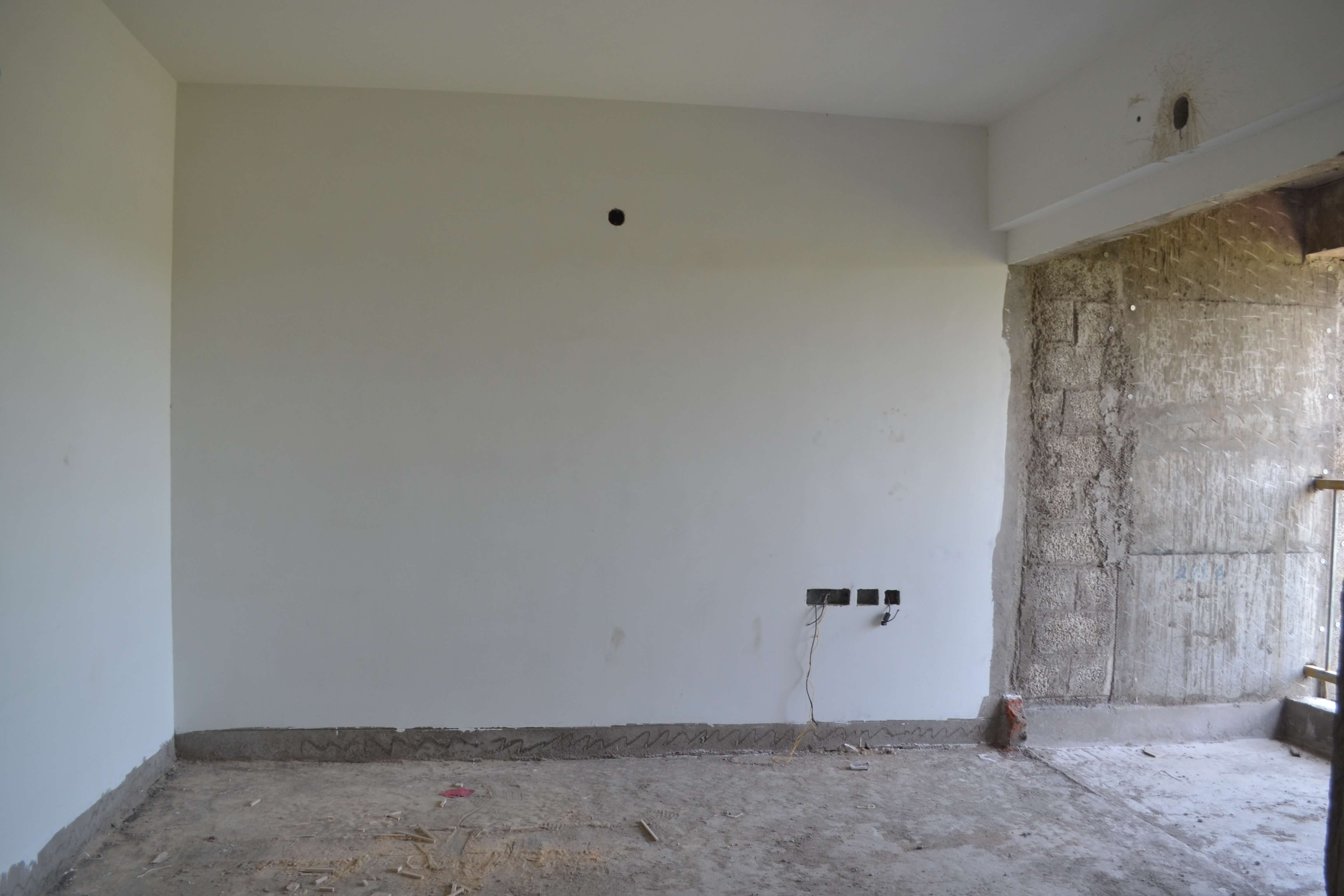

- Inside wall plastering work – 100% completed
- Wall chasing work – 100% completed
- Wire pulling work -80 flats completed
- DB fixing -80% completed
- Water Proofing work – 100% completed,terrace area-100% completed
- Electrical HT work – 70 % completed
- Plumbing work -(internal lines)100% ,duct lines(80%) completed.
- Tiling work – 78 flats completed (out of 118)
- External Plastering work – 95% completed
- Inside Putty work (1 coat) -95% completed
- Inside Putty work (2nd coat) – in progress
- External primer work – 95% completed
- Aluminium Fabrication work -60% completed
- Firework-100%completed
- Lift Work -40% completed
- Reticulated gas work-100%completed
As per the current work status from our site we are targeted to complete the following works by end of February 2019
- Wire pulling work -85 flats to be completed
- Electrical HT work – 75 % to be completed
- Plumbing work -duct lines(75%)100% to be completed.
- Tiling work -83 apts to be completed (out of 118)
- External Plastering work – 100% completed
- Inside Putty work (1 coat) – 100% to be completed
- Aluminium Fabrication work – 40% to be completed
Work status as on 05-02-2019, we have completed the following
- RCC for Structure – 100% completed
- Block/Brick masonry – 100% completed
- Door frame fixing – 100% completed
- Ceiling Plastering work – 100% completed
- Inside wall plastering work – 100% completed
- Wall chasing work – 100% completed
- Wire pulling work -70 flats completed
- Water Proofing work – 100% completed,terrace area-100%completed
- Electrical HT work – 50 % completed
- Plumbing work -(internal lines)100% ,duct lines(75%)completed.
- Tiling work – 67 flats completed (out of 118)
- External Plastering work – 95% completed
- Inside Putty work (1 coat) – 80% completed
- Inside Putty work (2nd coat) – in progress
- External primer
As per the current work status from our site we are targeted to complete the following works by end of January 2019
- Wire pulling work -80 flats to be completed
- Electrical HT work – 65 % to be completed

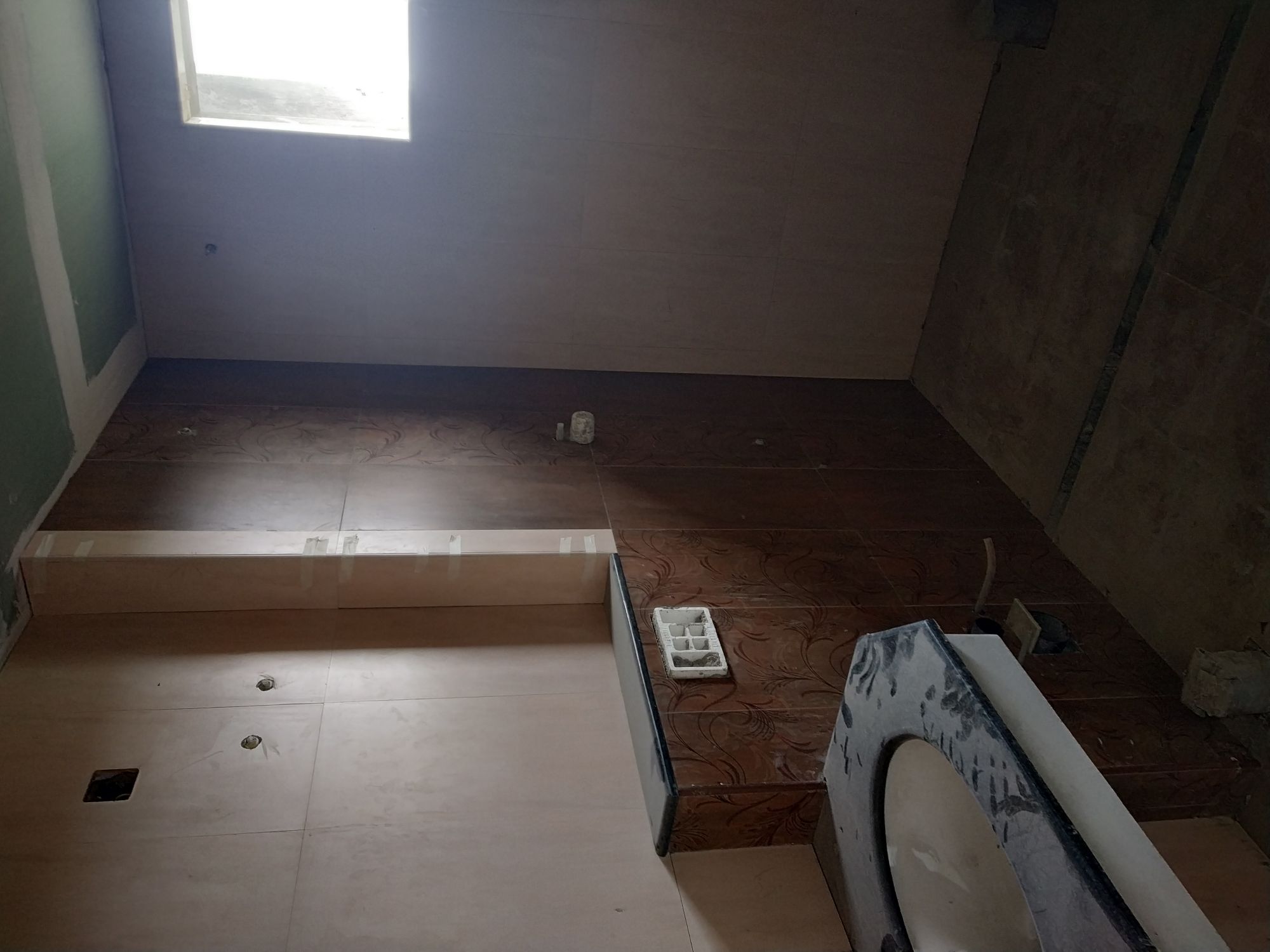

- Plumbing work -85% to be completed.
- Tiling work – 75 apts to be completed (out of 118)
- External Plastering work – 100% completed
- Inside Putty work (1 coat) – 80% to be completed
- External primer work – 100% to be completed
- Aluminium Fabrication work – 35% to be completed
Work status as on 08-01-2019, we have completed the following
- RCC for Structure – 100% completed
- Block/Brick masonry – 100% completed
- Door frame fixing – 100% completed
- Ceiling Plastering work – 100% completed
- Inside wall plastering work – 100% completed
- Wall chasing work – 100% completed
- Wire pulling work -65 flats completed
- Water Proofing work – 100% completed,terrace area-100%completed
- Electrical HT work – 40 % completed
- Plumbing work -70% completed.
- Tiling work – 63 flats completed (out of 118)
- External Plastering work – 95% completed
- Inside Putty work (1 coat) – 75% completed
- Inside Putty work (2nd coat) – in progress
- External primer work – 90% completed
- Aluminium Fabrication work – 20% completed
- Fire Work-100%completed
- Reticulated gas work-100%completed
As per the current work status from our site we are targeted to complete the following works by end of December 2019
- Water Proofing work – Terrace floor – 100% to be completed
- Electrical HT work – 40 % to be completed
- Plumbing work -100% to be completed
- Tiling work – 84 apts to be completed (out of 118)
- External Plastering work – 100% completed
- Inside Putty work (1 coat) – 80% to be completed
- External primer work – 100% to be completed
Work status as on 06-12-2018, we have completed the following
- RCC for Structure – 100% completed
- Block/Brick masonry – 100% completed
- Door frame fixing – 100% completed
- Ceiling Plastering work – 100% completed
- Inside wall plastering work – 100% completed
- Wall chasing work – 100% completed
- Wire pulling work -55 flats completed
- Water Proofing work – 100% completed,terrace area-95%completed
- Electrical HT work – 25 % completed
- Plumbing work – sleeve fixing (100% completed); Wall chasing (100%); sunken area filling with pcc (95% completed)
- Tiling work – 52 flats completed (out of 118)
- External Plastering work – 95% completed
- Inside Putty work (1 coat) – 65% completed
- Inside Putty work (2nd coat) – in progress
- External primer work – 90% completed
- Fire Work-100%completed
- Reticulated gas work-100%completed
As per the current work status from our site we are targeted to complete the following works by end of November 2018
- Door frame fixing – 100% to be completed
- Inside wall plastering work – Terrace floor – 100% to be completed
- Water Proofing work – Terrace floor – 100% to be completed
- Plumbing work – 19th floor – 100% to be completed
- Tiling work – 48 apts to be completed (out of 118)
- Inside Putty work (1 coat) – 75% to be completed
- External primer work – 100% to be completed
Work status as on 15-11-2018, we have completed the following.
- RCC for Structure – 100% completed
- Block/Brick masonry – 100% completed
- Door frame fixing – 98% completed
- Ceiling Plastering work – 100% completed
- Inside wall plastering work – 3rd to 20th floor (completed); Terrace floor (75% completed)
- Wall chasing work – 100% completed
- Wire pulling work – 44 flats completed
- Water Proofing work – 95% completed
- Electrical HT work – progressing
- Plumbing work – sleeve fixing (100% completed); Wall chasing (3rd to 18th floor; 19th floor in progress); sunken area filling with pcc (3rd to 18th floor; 19th floor in progress)
- Tiling work – 44 flats completed (out of 118)
- External Plastering work – 85% completed
- Inside Putty work (1 coat) – 50% completed
- Inside Putty work (2nd coat) – in progress
- External primer work – 70% completed
As per the current work status from our site we are targeted to complete the following works by end of July 2018
- Door frame fixing – 100% to be completed
- Inside wall plastering work – 20th floor – 100% to be completed
- Water Proofing work – 100% to be completed
- Plumbing work – 11th & 12th floor – 100% to be completed
- Tiling work – 3rd & 4th floor – 100% to be completed
- Inside Putty work (1 coat) – 10th floor – 100% to be completed
Work status as on 05-06-2018, we have completed the following.
- RCC for Structure – 100% completed
- Block/Brick masonry – 100% completed
- Door frame fixing – 98% completed
- Ceiling Plastering work – 100% completed
- Inside wall plastering work – 3rd to 19th floor (completed); 20th floor (progressing)
- Wall chasing work – 100% completed
- Water Proofing work – inside toilet + balcony (3rd to 16th floor (completed); 17th floor (progressing)
- Plumbing work – sleeve fixing (3rd to 18th floor); Wall chasing ( 3rd to 10th floor); sunken area filling with pcc (12th floor in progress)
- Tiling work – toilet (wall + floor) 3D sample; 3rd to 6th floor completed; Floor tile (3D sample, 3(E-F),(4D-E-F-G), (5D-E-F), (6D-E)
- External Plastering work – 55% completed
- Inside Putty work (1 coat) – 3D sample, 3rd to 9th floor (100% completed)
As per the current work status from our site we are targeted to complete the following works by end of May 2018
- Door frame fixing – 100% to be completed
- Inside wall plastering work – 100% to be completed
- Wall chasing work – 100% to be completed
- Water Proofing work – 80% to be completed
- Tiling work – 50% to be completed
Work status as on 05-05-2018, we have completed the following.
- RCC for Structure – 100% completed
- Block/Brick masonry – 100% completed
- Door frame fixing – 98% completed
- Ceiling Plastering work – 100% completed
- Inside wall plastering work – 90% completed
- Wall chasing work – 95% completed
- Water Proofing work – 70% completed
- Plumbing work – 50% completed
- Tiling work – 15% completed
- External Plastering work – East side (90% completed); South side(50% completed); West side (started); North side (25% completed)
- Inside Putty work – 3rd & 4th floor (100% completed);6th floor (60% completed)
As per the current work status from our site we are targeted to complete the following works by end of April 2018
- Block/Brick masonry – 100% to be completed
- Door frame fixing – 100% to be completed
- Inside wall plastering work – 100% to be completed
- Wall chasing work – 19th floor – 100% to be completed
- Water Proofing work – 100% to be completed
- Plumbing work – 100% to be completed
- Handrail Fabrication work – A,B & G flats- 20th floor -100% to be completed
- Tiling work – 100% to be completed
- Inside Putty work -100% to be completed
Work status as on 16-04-2018, we have completed the following.
- Door frame fixing – 18th floor (100% completed);19th floor(70% completed)
- Ceiling Plastering work – 20th floor (100% completed)
- Inside wall plastering work – 13th to 18th floor (100% completed)
- Wall chasing work – 14th floor (100% completed); 15th floor to18th floor(100% completed);19th floor (progressing)
- Water Proofing work – 3rd,4th,5th & 7th to 12th floor(100% completed);13th & 14th floor(20% completed)
- Plumbing work – 9th to 15th floor (Sleeve fixing-100%completed);3rd to 5th floor(consealed piping-100% completed);6th floor(100% completed)
- Handrail Fabrication work – C,D,E &F flats 1st to 20th floor(100% completed);A,B,G flats 1 to 19th floor(100% completed)
- Tiling work – 3rd floor & 4th floor toilets (90% completed)
- Inside Putty work – 3rd & 4th floor (100% completed);6th floor(60% completed)
As per the current work status from our site we are targeted to complete the following works by end of March 2018
- Block/Brick masonry – 100% to be completed
- Inside wall plastering work – 15th,16th & 17th floor – 100% to be completed
- Inside Putty work -100% to be completed
- Wall chasing work – 15th floor – 100% to be completed
- Door frame fixing – 100% to be completed
- Handrail Fabrication work – A,B & G flats-17 to 20th floor 100% to be completed
- Tiling work – 3rd floor- 100% to be completed
- Water Proofing work – 100% to be completed
- Plumbing work – 100% to be completed
Work status as on 10-03-2018, we have completed the following.
- RCC for Structure – 100% completed
- Block/Brick masonry – 20th floor – 100% completed
- Ceiling Plastering work – 20th floor (100% completed)
- Inside wall plastering work – 13th & 14th floor (100% completed); 15th floor (95% completed);16th floor (90% completed);17th floor(50% completed)
- Inside Putty work – 3rd &4th floor (100% completed);6th floor(60% completed)
- Wall chasing work – 14th floor – 100% completed; 15th floor (50% completed);18th floor(20% completed)
- Door frame fixing – 18th floor (100% completed);19th floor(progressing)
- Handrail Fabrication work – C,D,E &F flats 1st to 20th floor(100% completed);A,B,G flats 1 to 16th floor(100% completed);17th floor(A,B,G flats-progressing)
- Tiling work – 3rd floor (D-flat 80% completed)
- Water Proofing work – 3rd,4th,5th,7th,8th, 9th,10th & 11th floor (100% completed);12th floor(20% completed);13th floor(20% completed)
- Plumbing work – 9th to 13th floor (Sleeve fixing-100%completed);3rd to 5th floor(consealed piping-60% completed);6th floor(progressing)
Work status as on 10-02-2018, we have completed the following

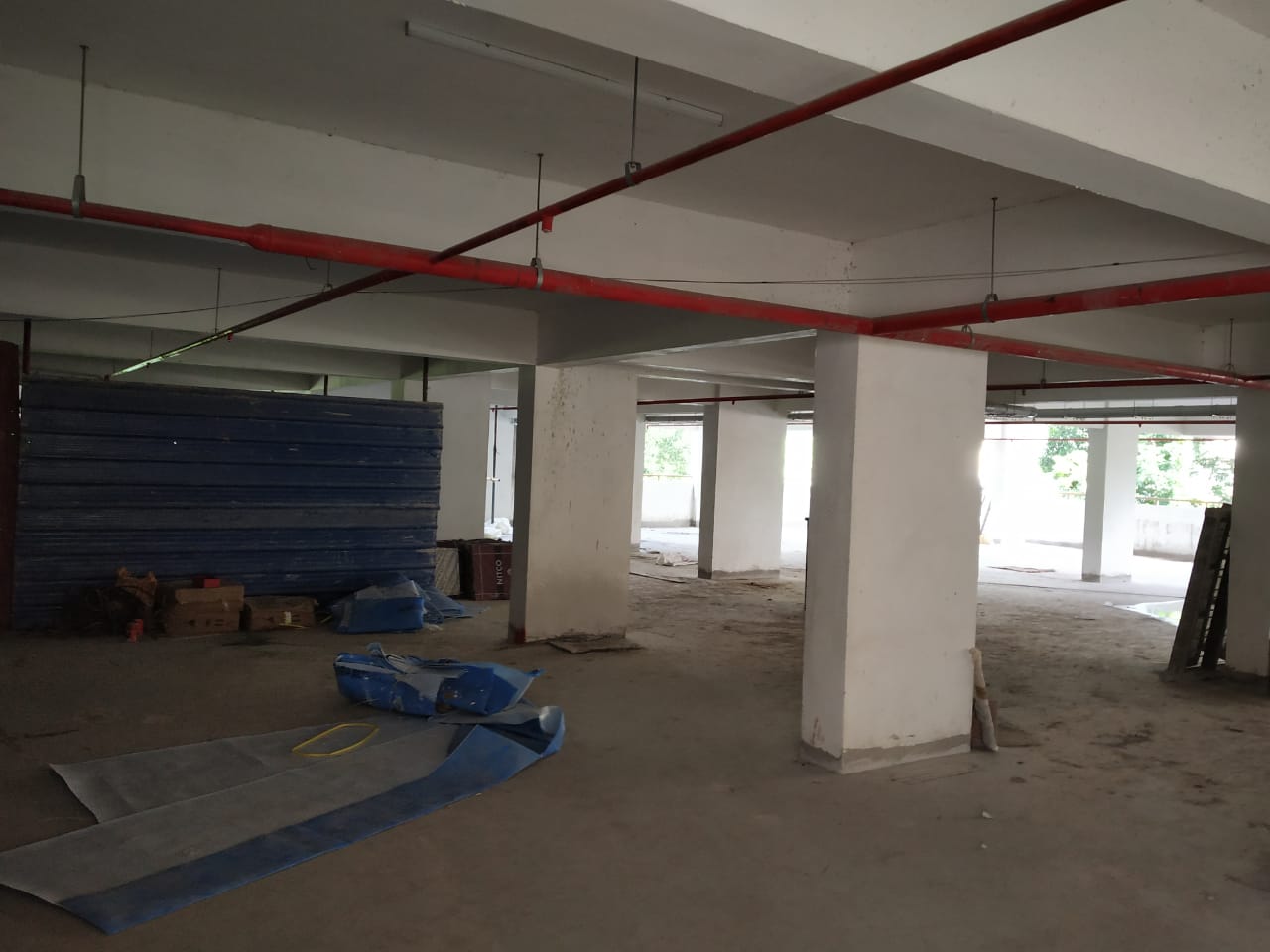

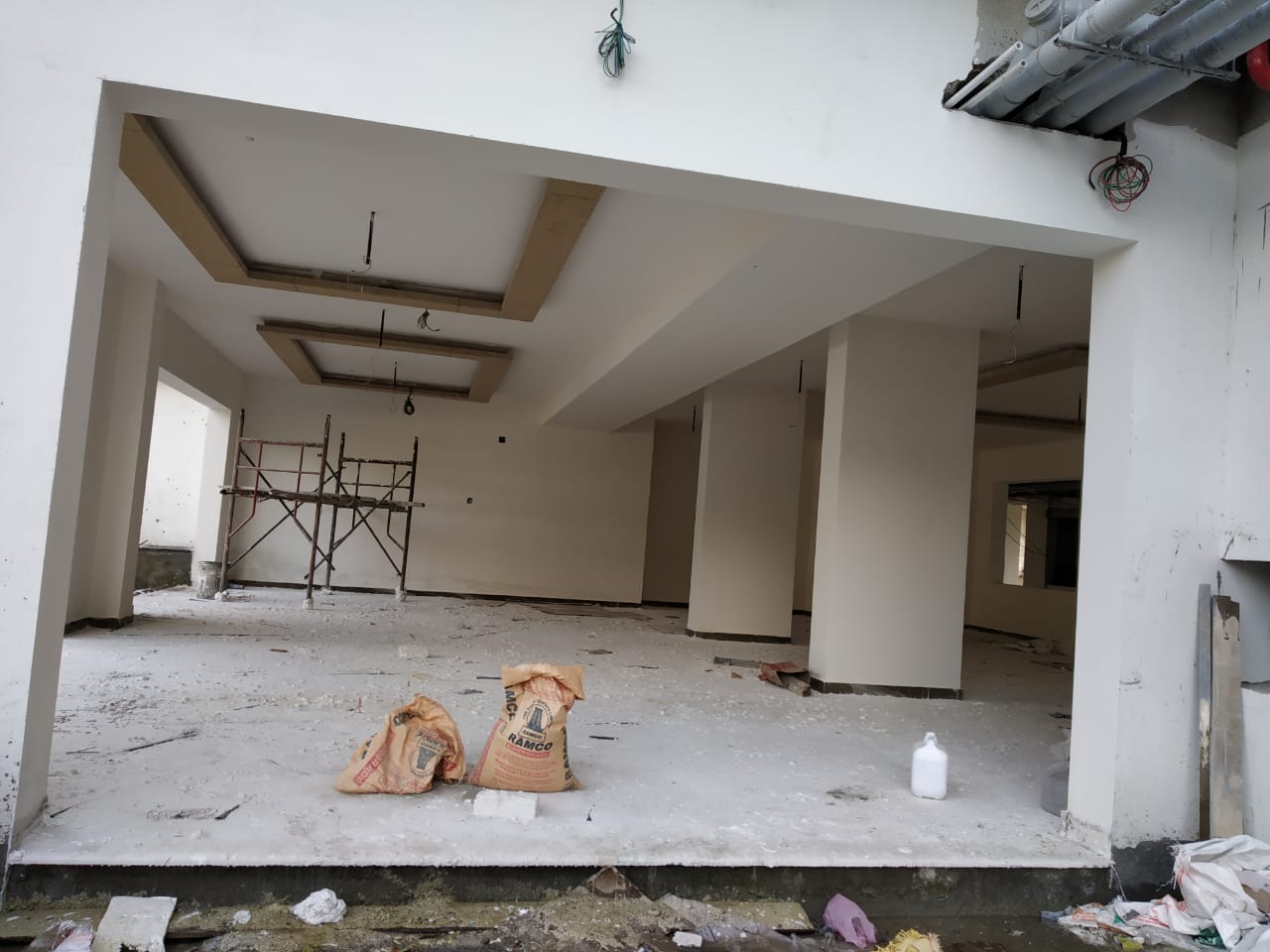

- Ceiling Plastering work – 20th floor (100% completed)
- Inside wall plastering work – 13th & 14th floor (100% completed); 15th floor (95% completed);16th floor (40% completed)
- Wall chasing work – 14th floor – 100% completed; 15th floor (50% completed)
- Water Proofing work – 3rd,4th,5th,7th,8th, 9th & 10th floor (100% completed);11th floor(progressing)

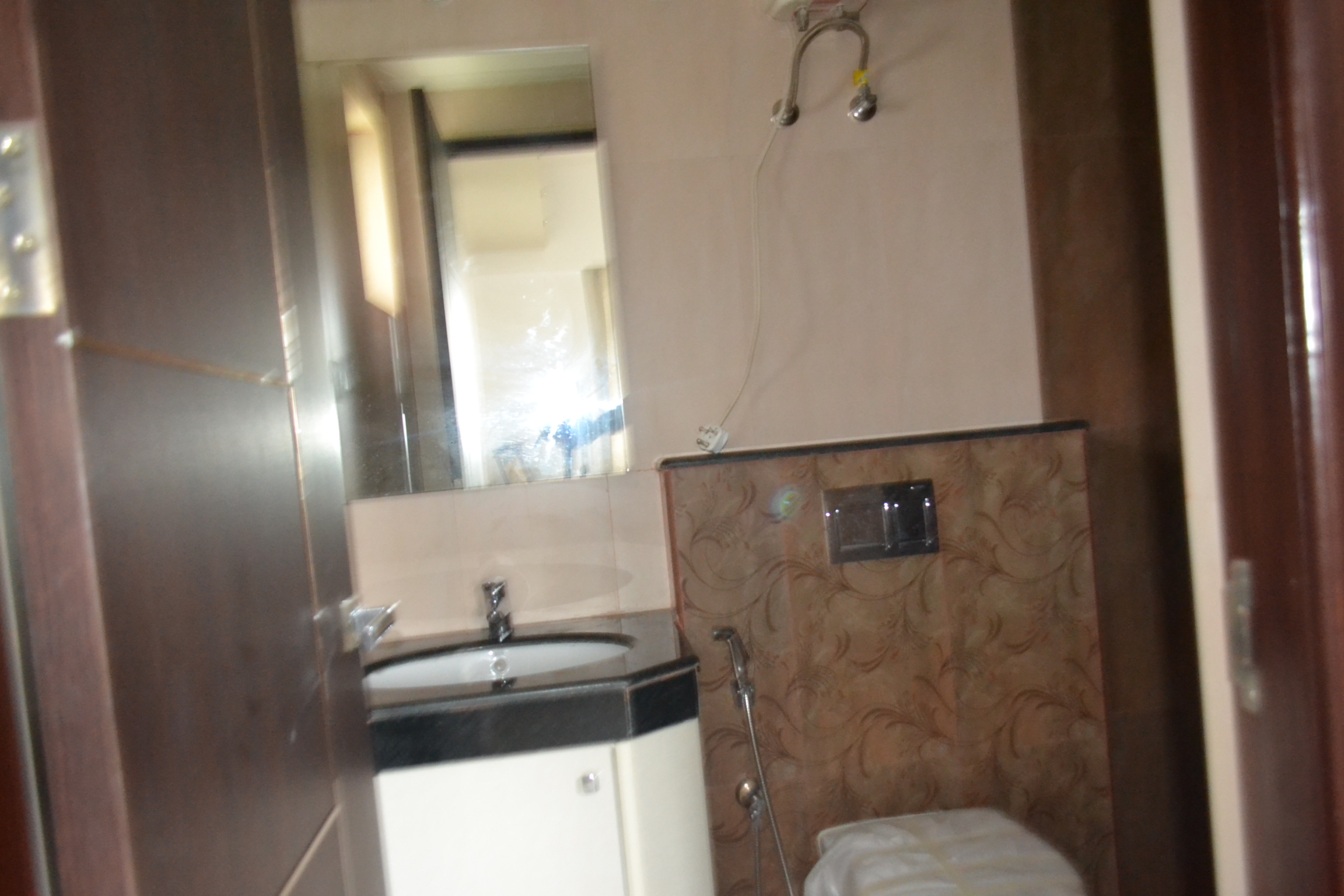

- Plumbing work – 9th to 13th floor -100%completed
- Handrail Fabrication work – C,D,E &F flats 1st to 20th floor(100% completed);A,B,G flats 1 to 16th floor(100% completed);17th floor(A,B,G flats-progressing)

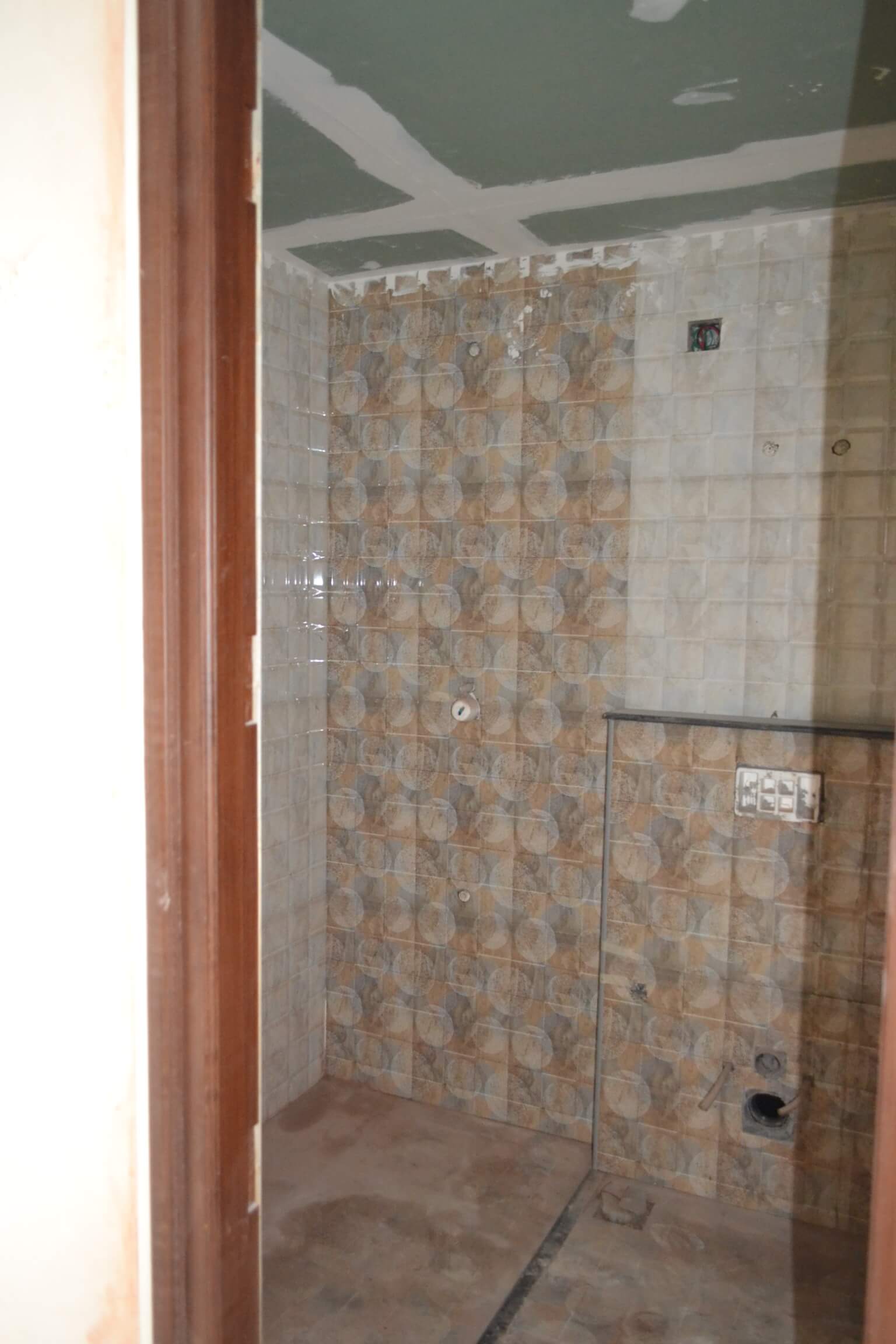

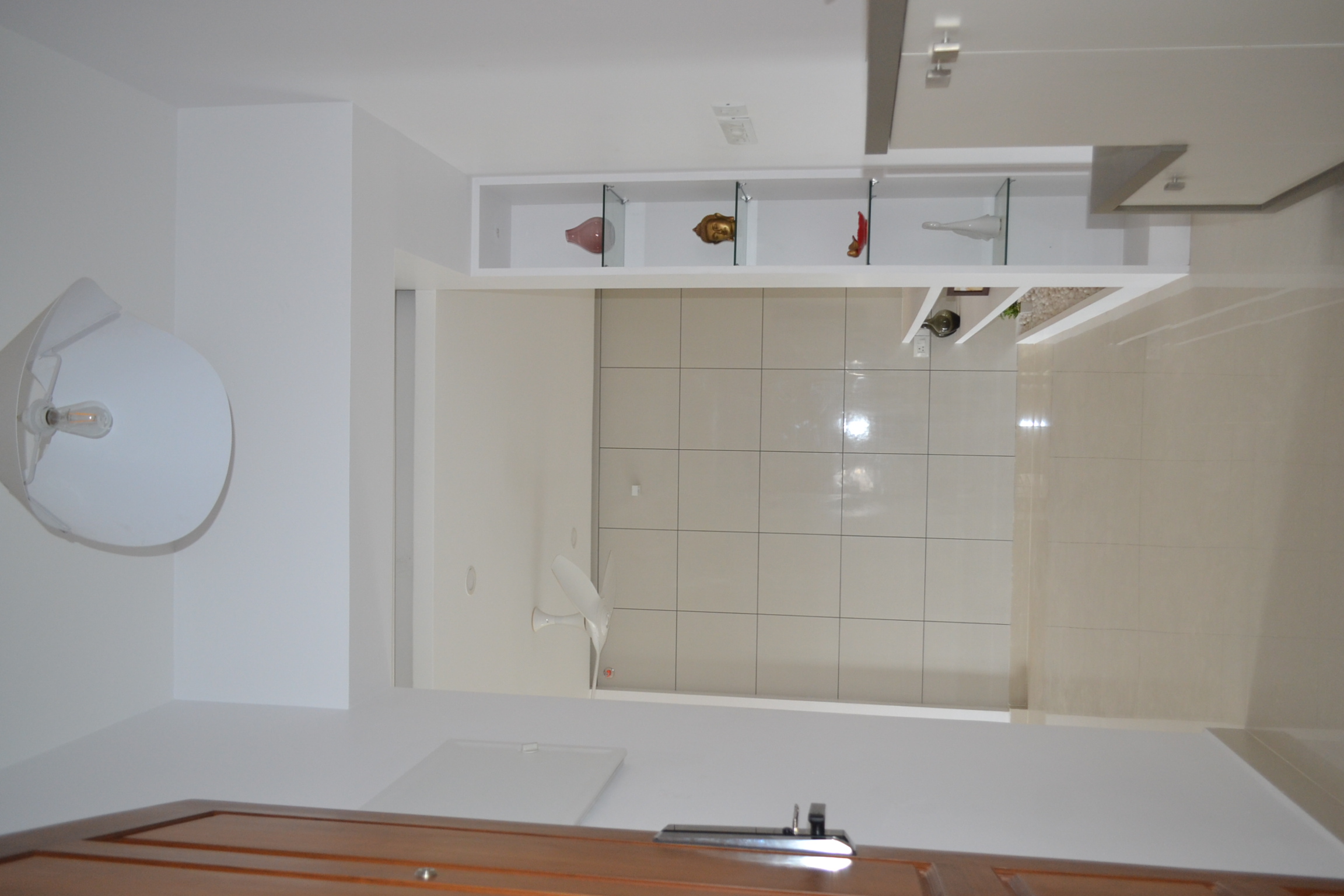

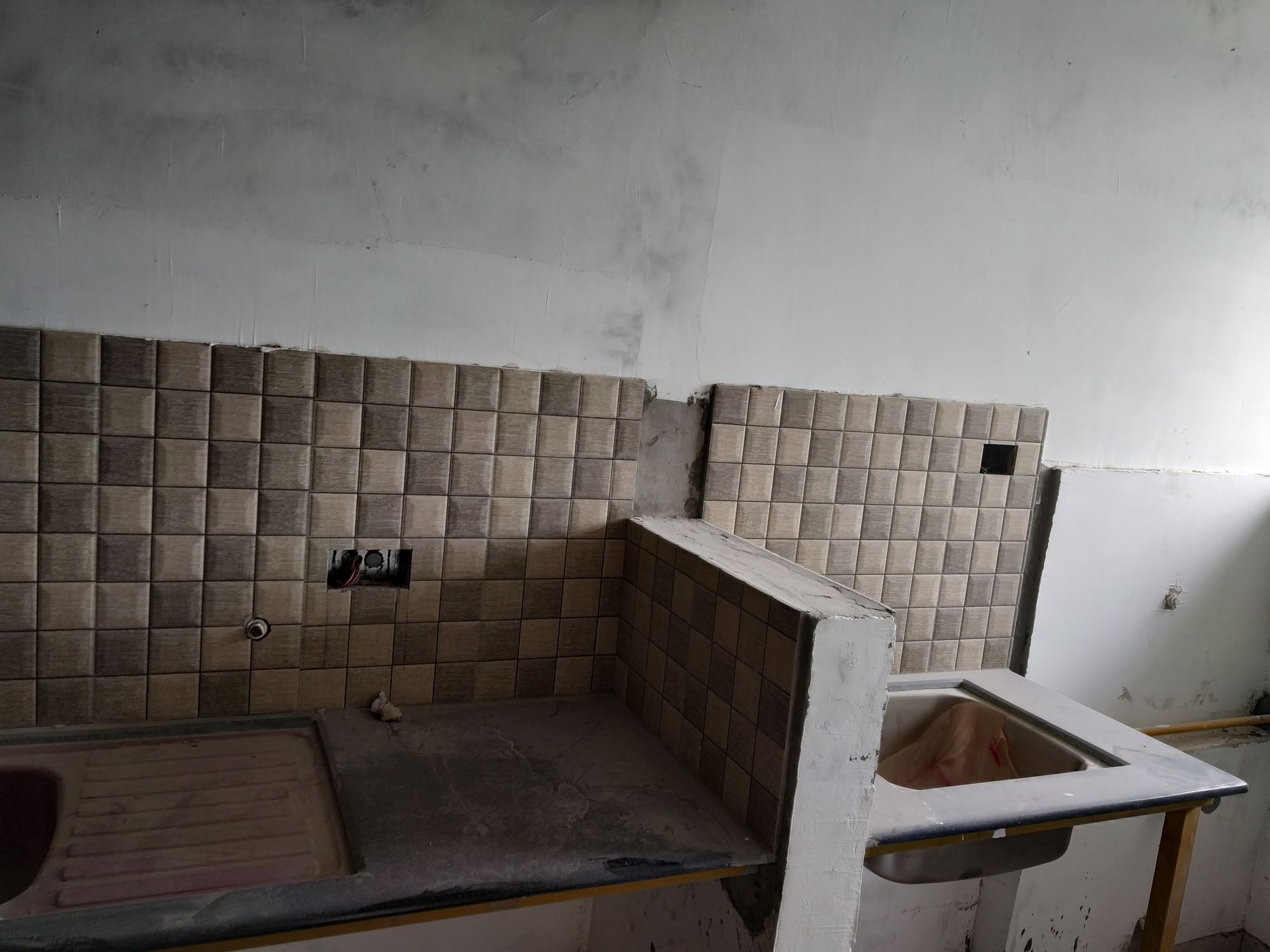

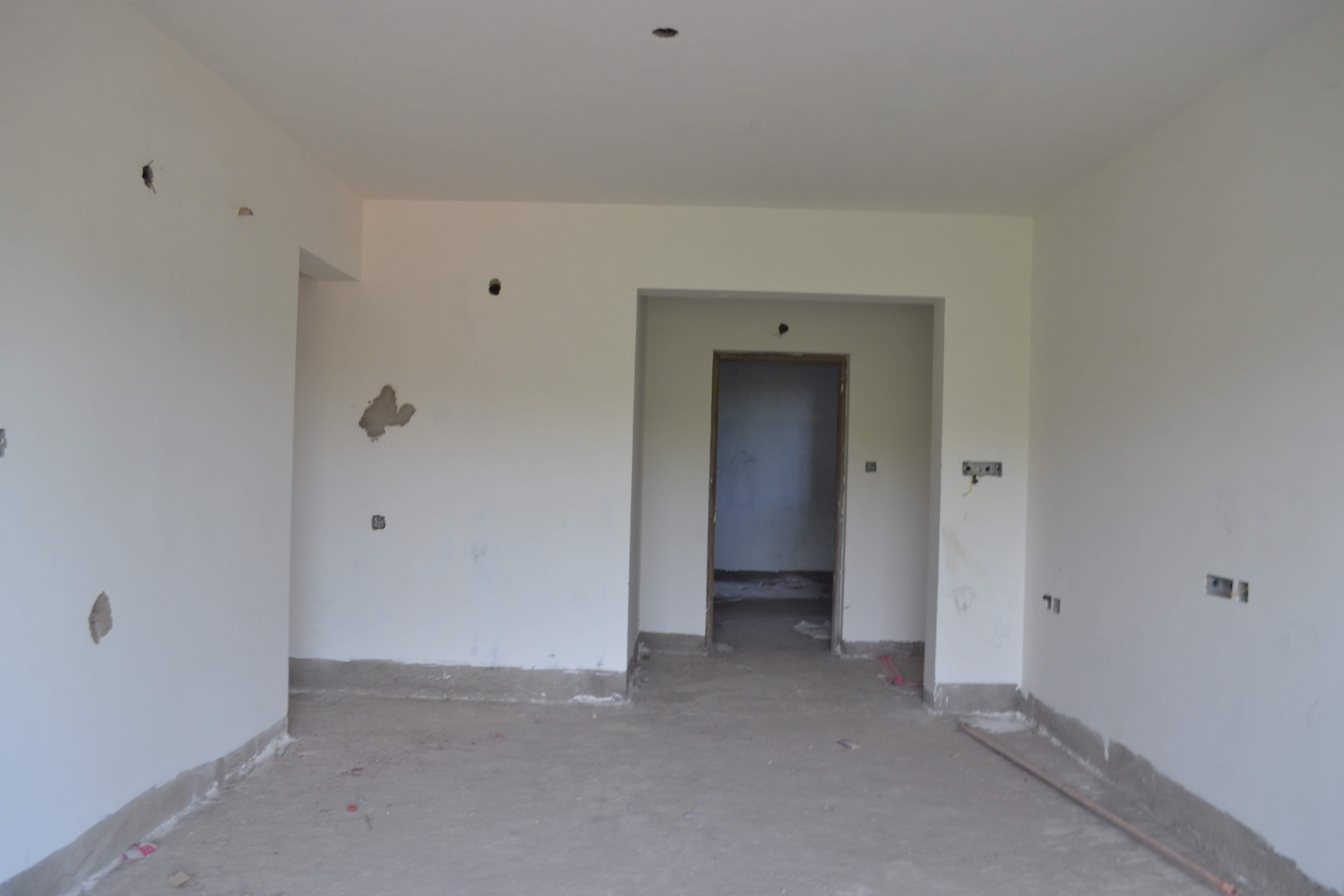

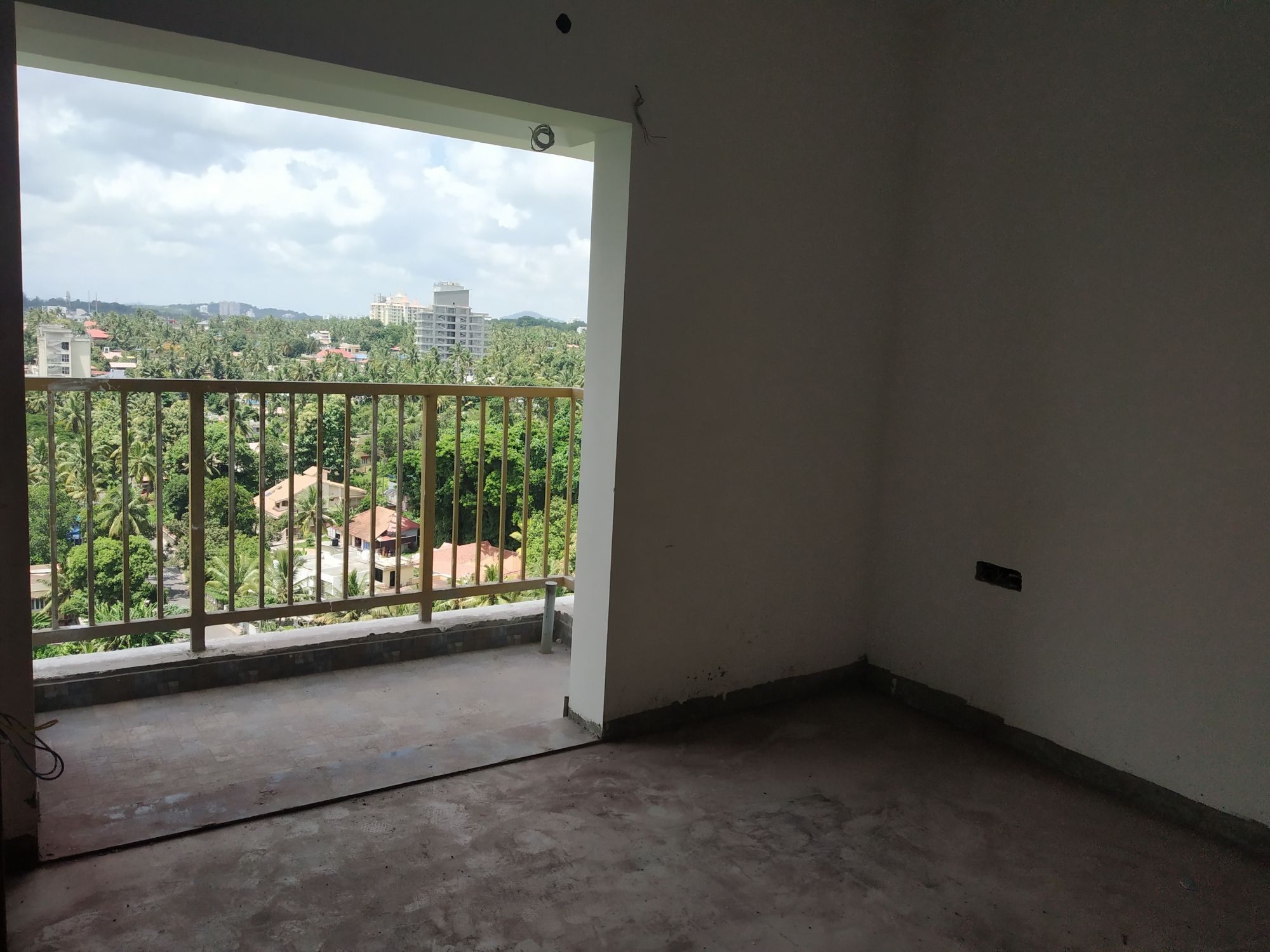

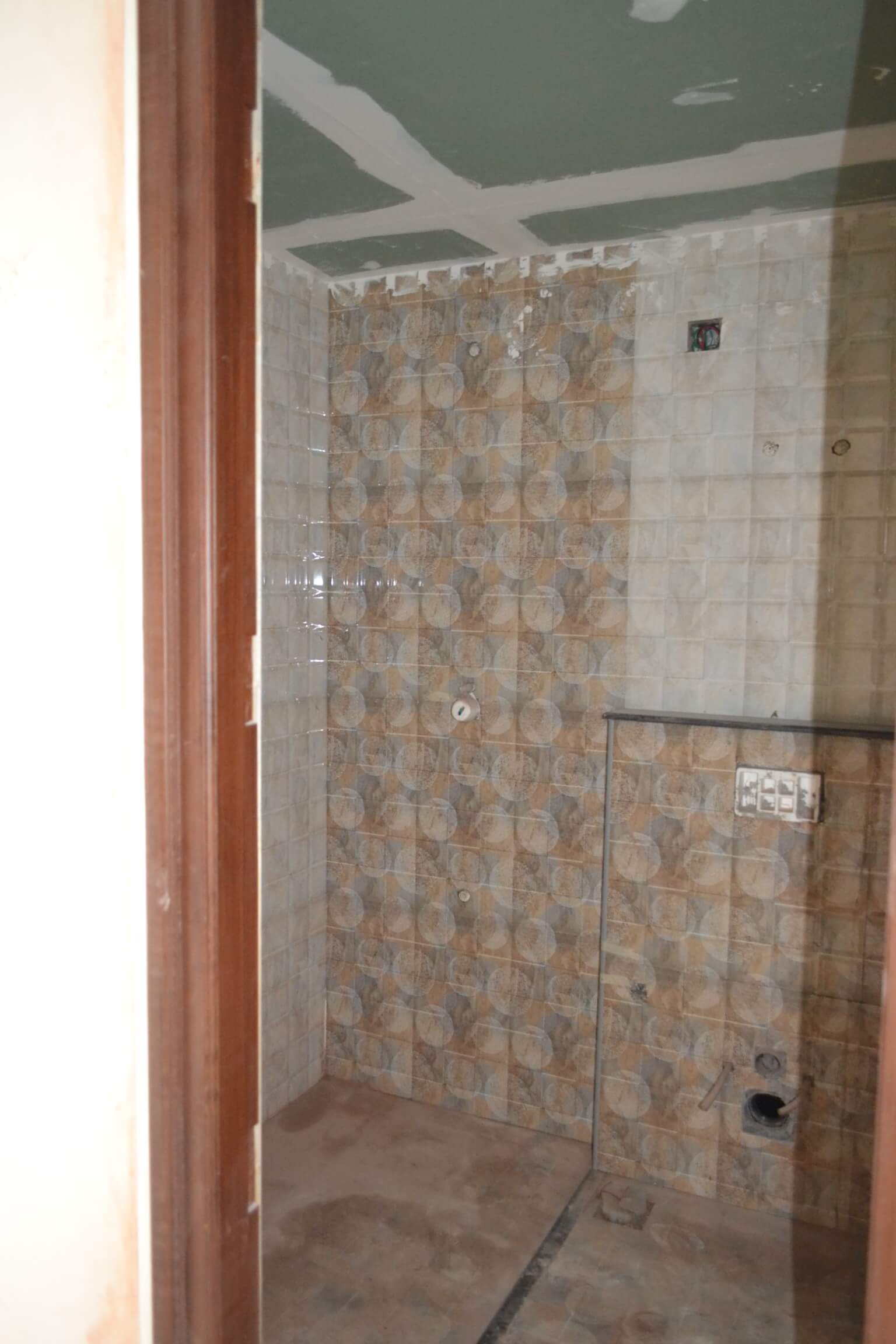

- Tiling work – 3rd floor (D-flat 80% completed)

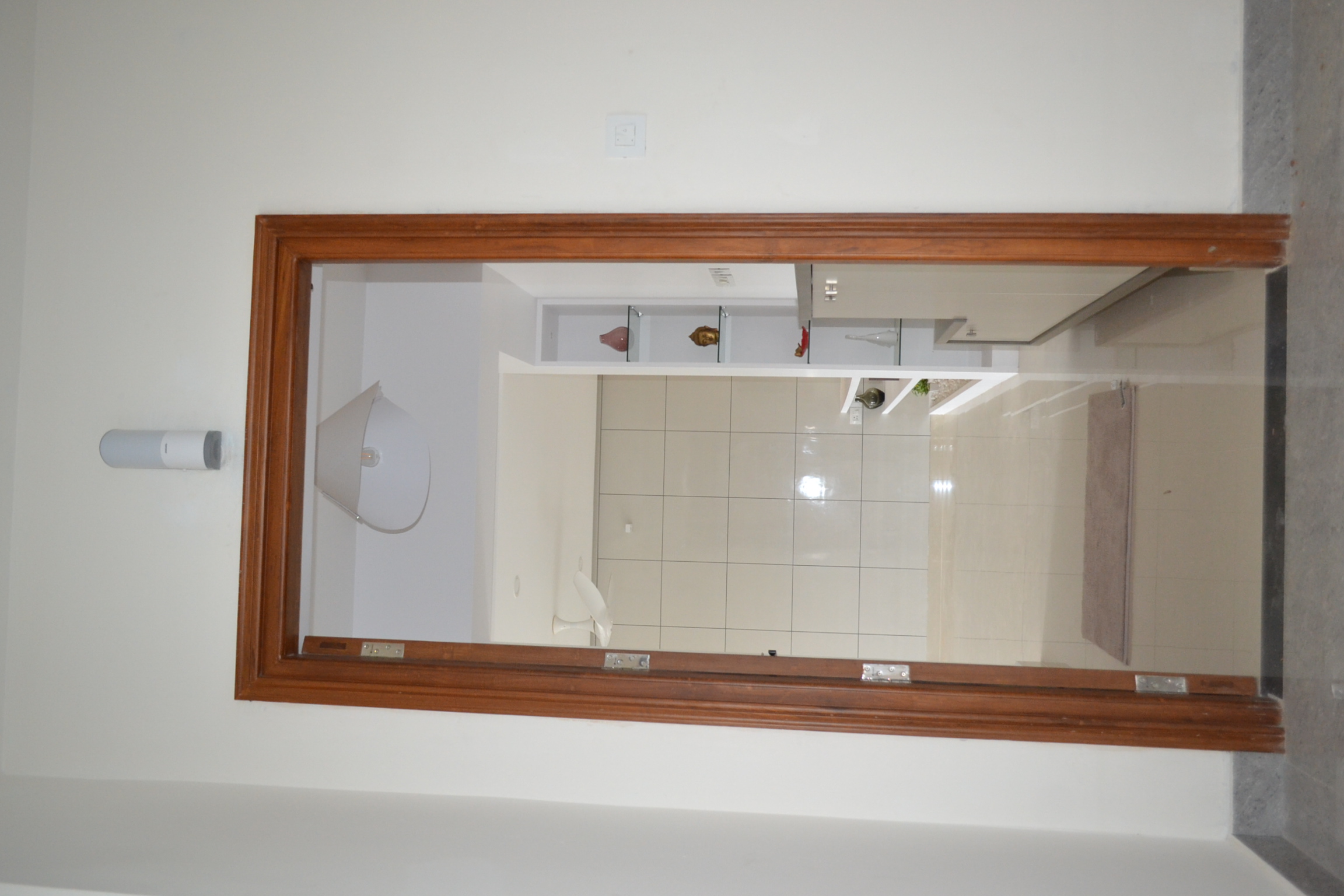

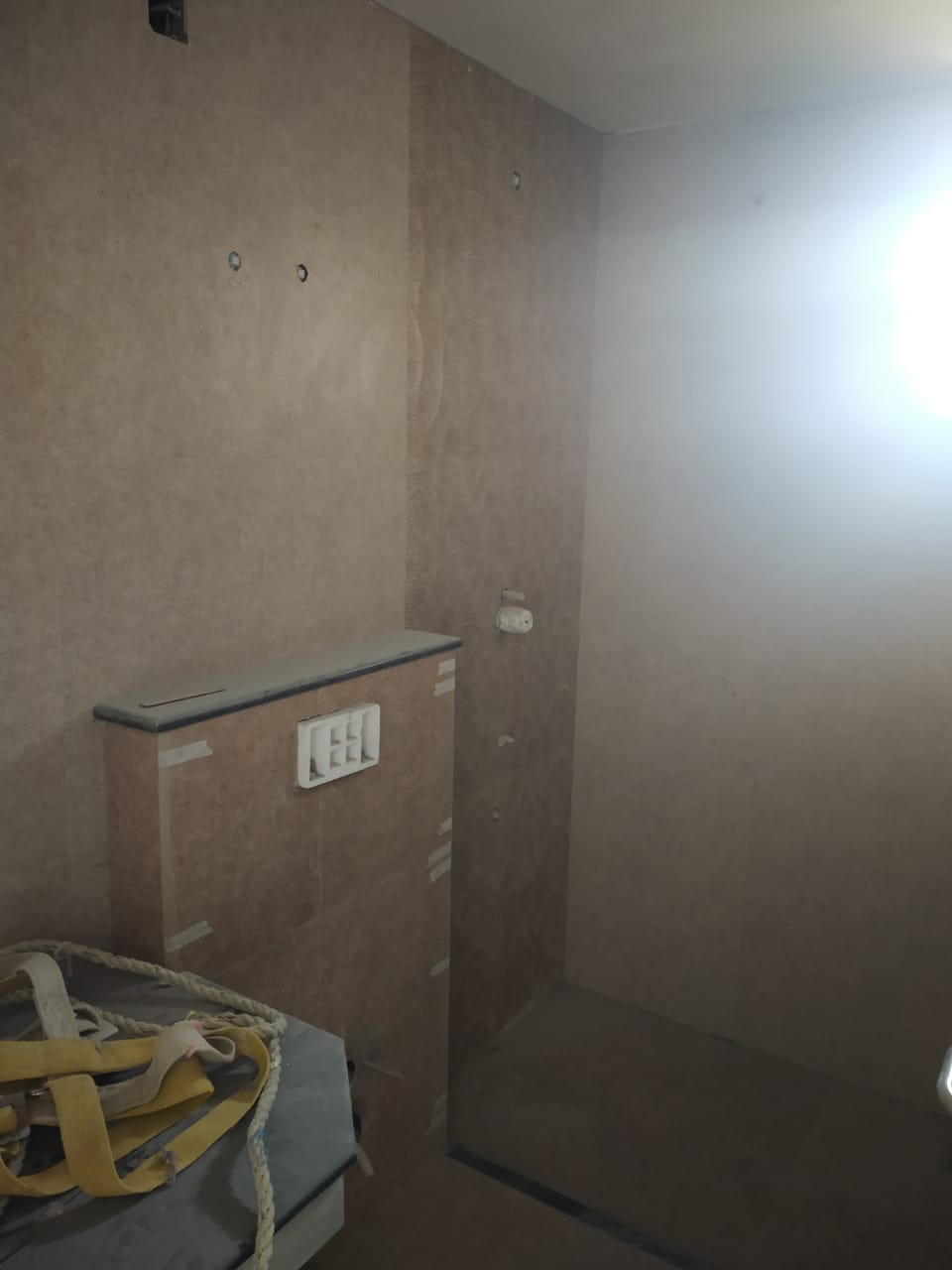

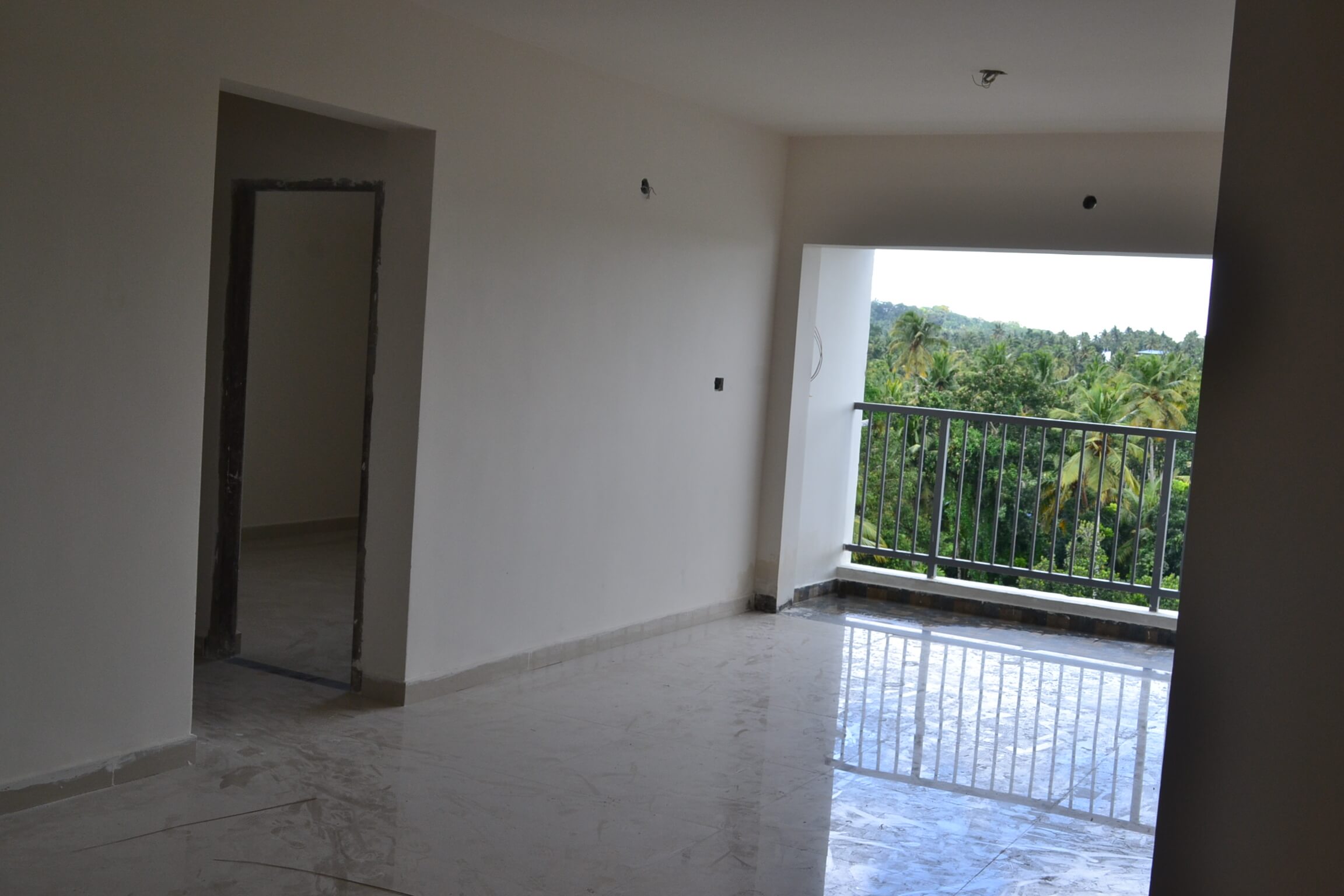

- Inside Putty work – 3rd &4th floor (75% completed)
As per the current work status from our site we are targeted to complete the following works by end of February 2018
- Block/Brick masonry – 100% to be completed
- Door frame fixing – 100% to be completed
- Inside wall plastering work – 15th & 16th floor – 100% to be completed
- Wall chasing work – 15th floor – 100% to be completed
- Water Proofing work – 100% to be completed
- Plumbing work – 100% to be completed
- Handrail Fabrication work – A,B & G flats-17 to 20th floor 100% to be completed
- Tiling work – 3rd floor- 100% to be completed

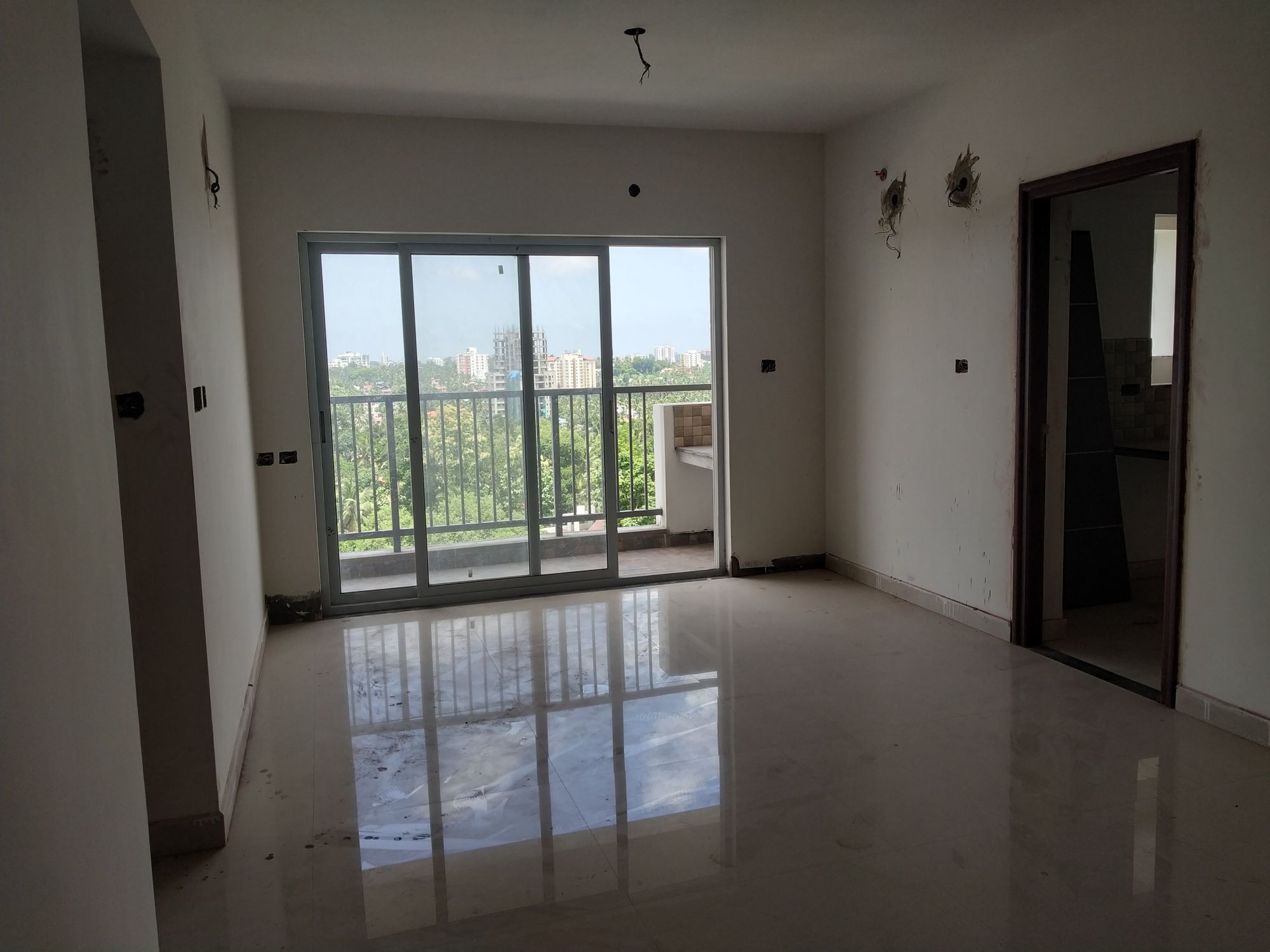

- Inside Putty work – 3rd floor -100% to be complete
As per the current work status from our site we are targeted to complete the following works by end of December, 2017
- Block/Brick masonry – 100% to be completed
- Door frame fixing – 100% to be completed
- Ceiling Plastering work – 20th floor roof – 100% to be completed
- Inside wall plastering work – 14th floor – 100% to be completed
- Wall chasing work – 15th floor – 100% to be completed
- Water Proofing work – 9th floor – 100% to be completed
- Plumbing work – 100% to be completed
- Handrail Fabrication work – 100% to be completed
- Tiling work – 3rd floor 100% to be completed
- Inside Putty work – 3rd floor 100% to be completed

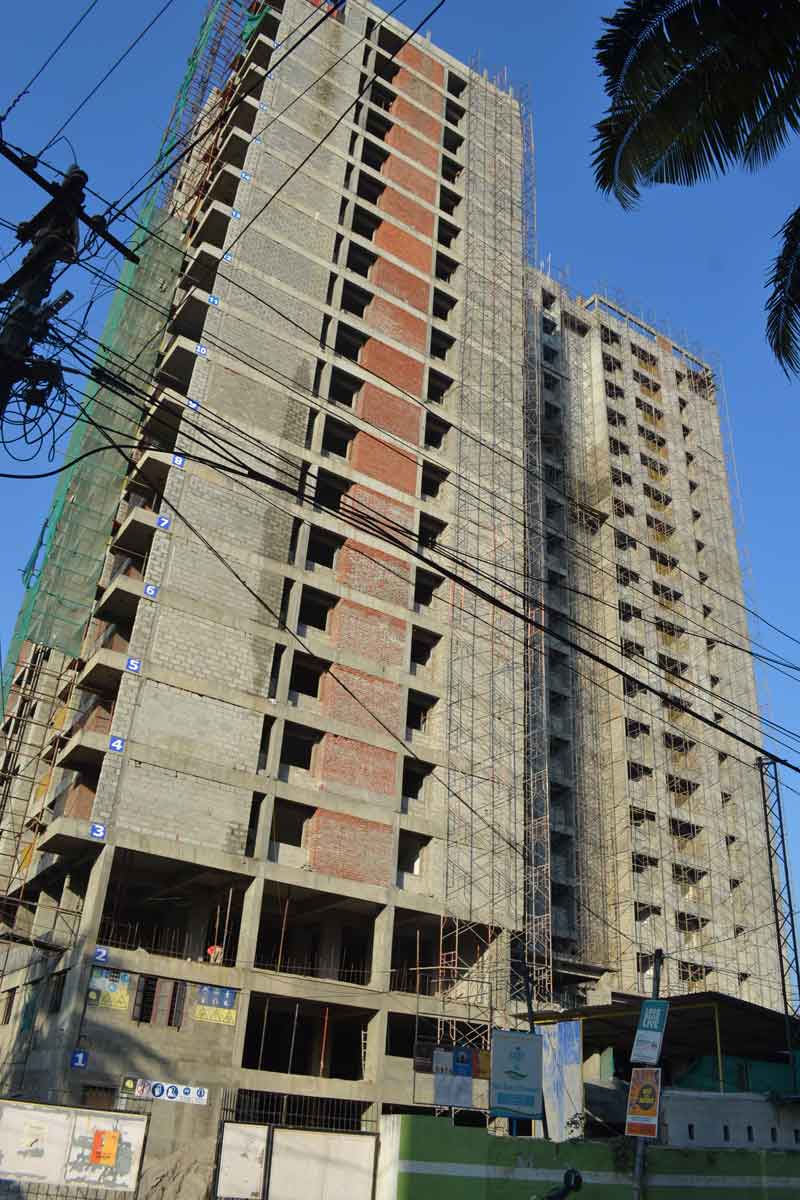

Work status as on 10-12-2017, we have completed

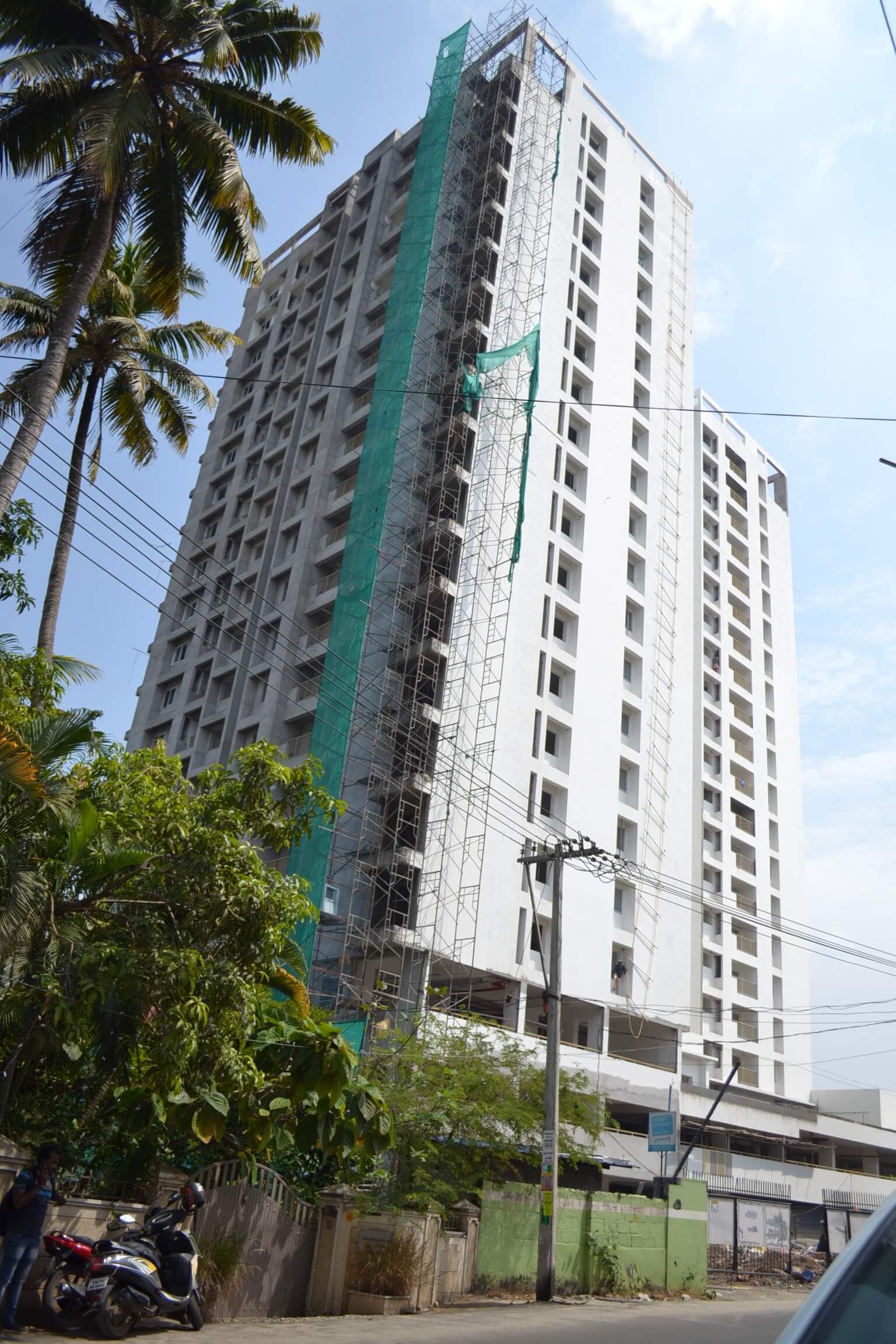

- RCC for Structure – 100% completed
- Block/Brick masonry – 19th floor – 100% completed
- Door frame fixing – 16th floor – 50% completed

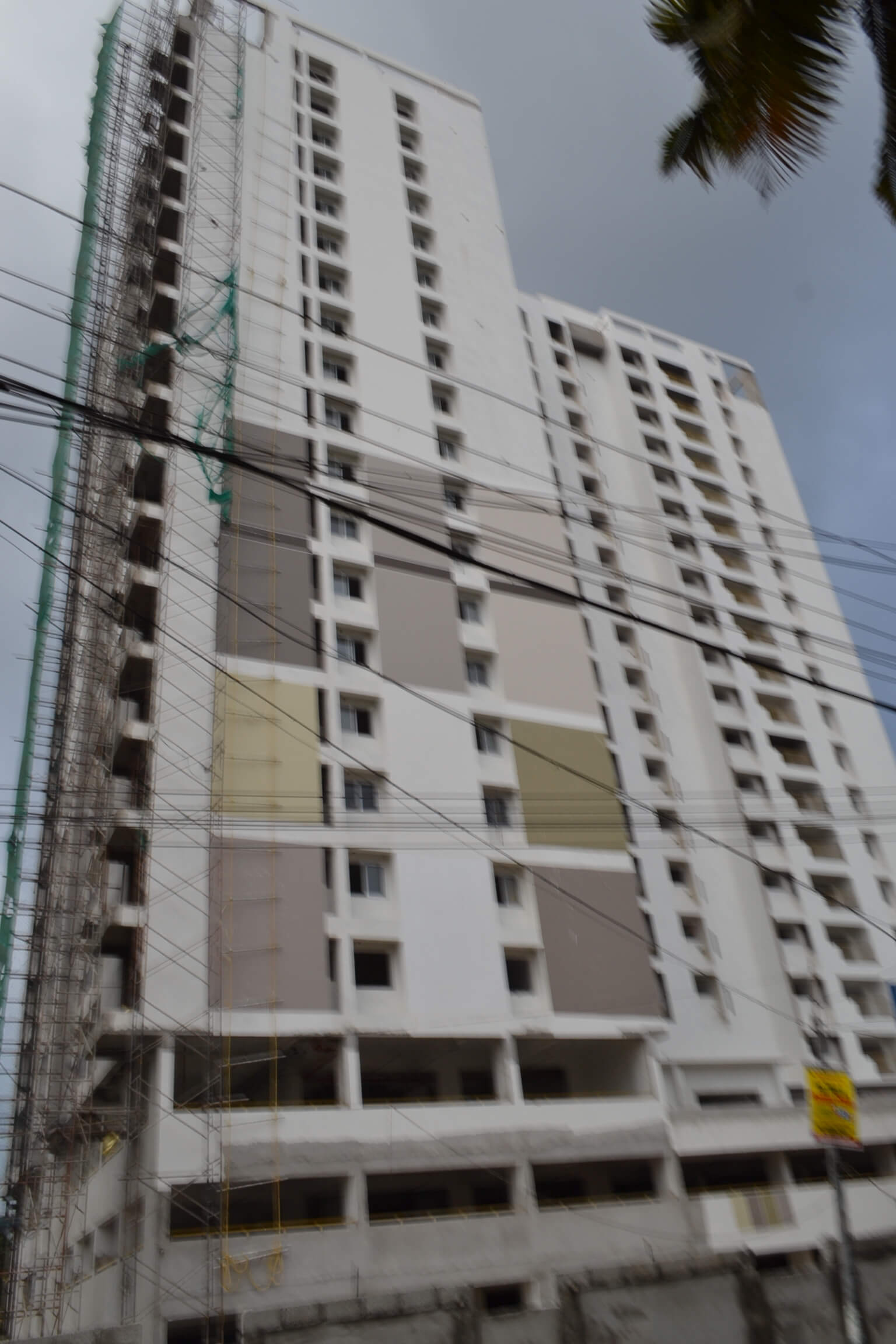

- Ceiling Plastering work – 20th floor 95% completed
- Inside wall plastering work – 13th floor – 100% completed; 14th floor (progressing)
- Wall chasing work – 14th floor – 100% completed; 15th floor (progressing)
- Water Proofing work – 7th floor & 8th floor -100% completed.
- Plumbing work – 9th to 12th floor -100%completed
- Handrail Fabrication work -11th floor & 14th floor (progressing)
- Tiling work – 3rd floor (D-flat 80% completed)
- Inside Putty work – 3rd floor (progressing)
Work status as on 5-7-2017, we have completed
- RCC for Structure – 19th roof – completed
- Block/Brick masonry – 13th & 14th floor – completed
- Ceiling Plastering work – 17th floor roof – completed
- Inside wall plastering work – progressing
Work status as on 9-5-2017, we have completed
- RCC for Structure – 19th floor – completed
- Block/Brick masonry – 13th floor – progressing
- Ceiling Plastering work – 17th floor roof – completed
- Wall chasing work – 9th floor – progressing
As of 06-03-2015, we had completed 59 Nos of piling work (out of 182)
- The following work are expected to be completed by next month.
- Piling work – 40nos – out of 182.
You must be logged in to post a comment.
