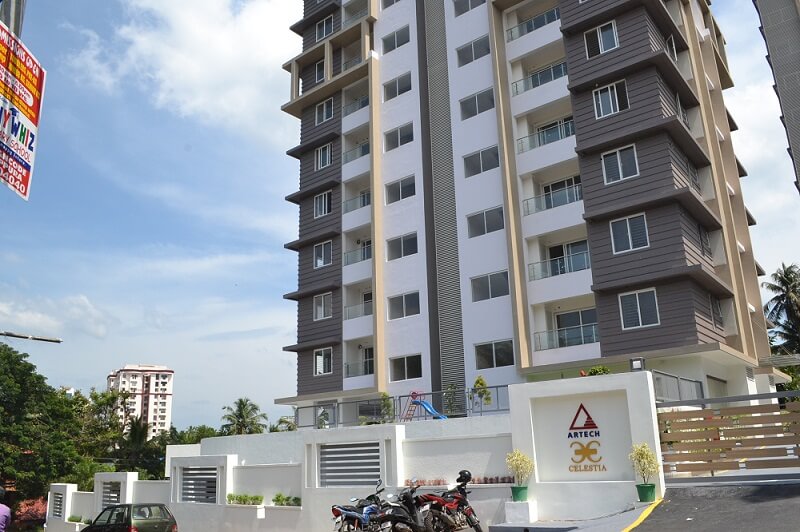

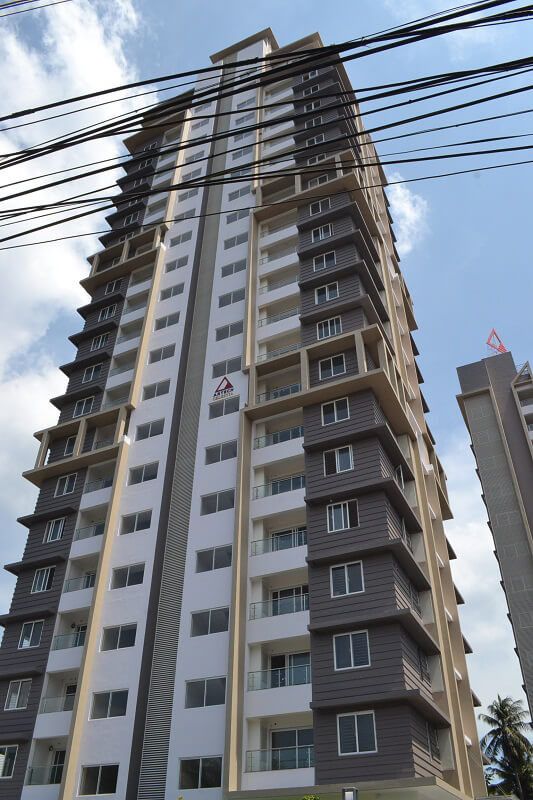

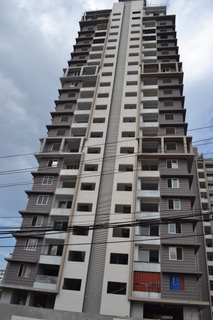

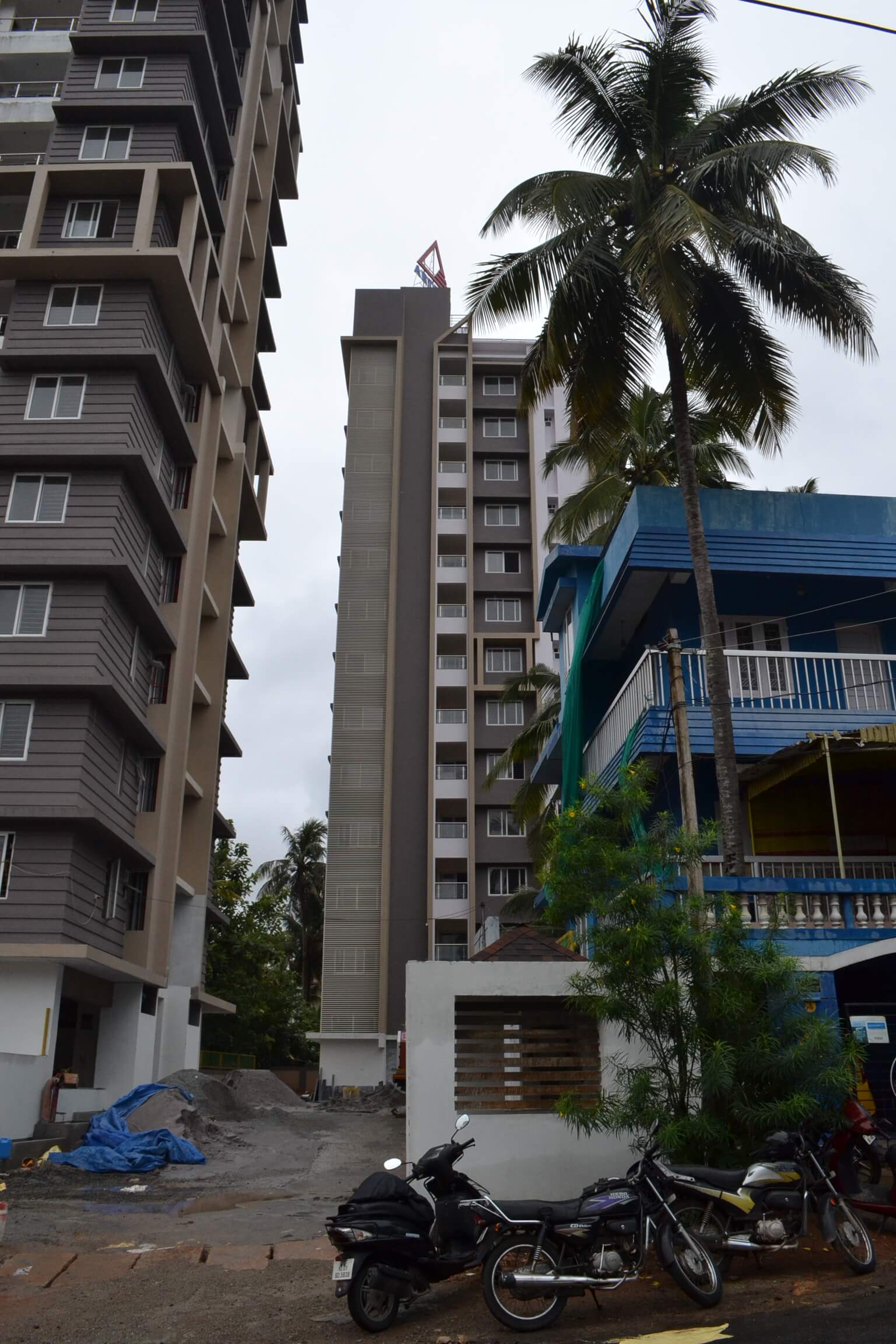

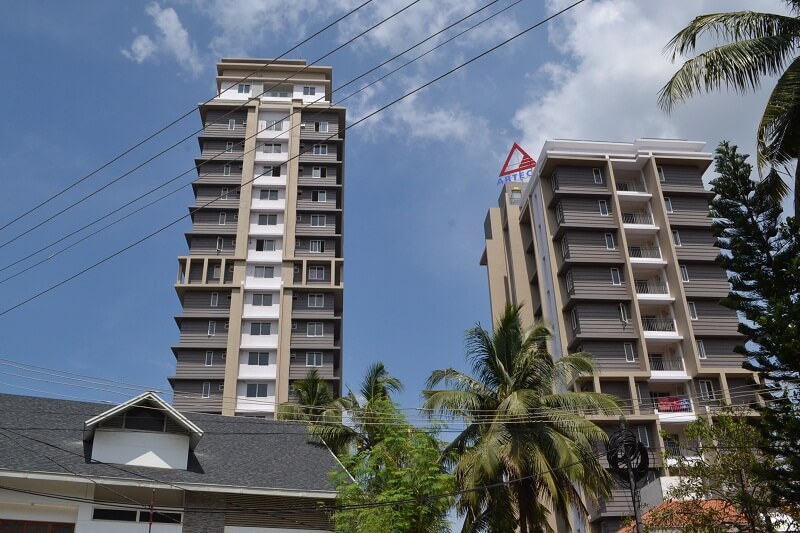

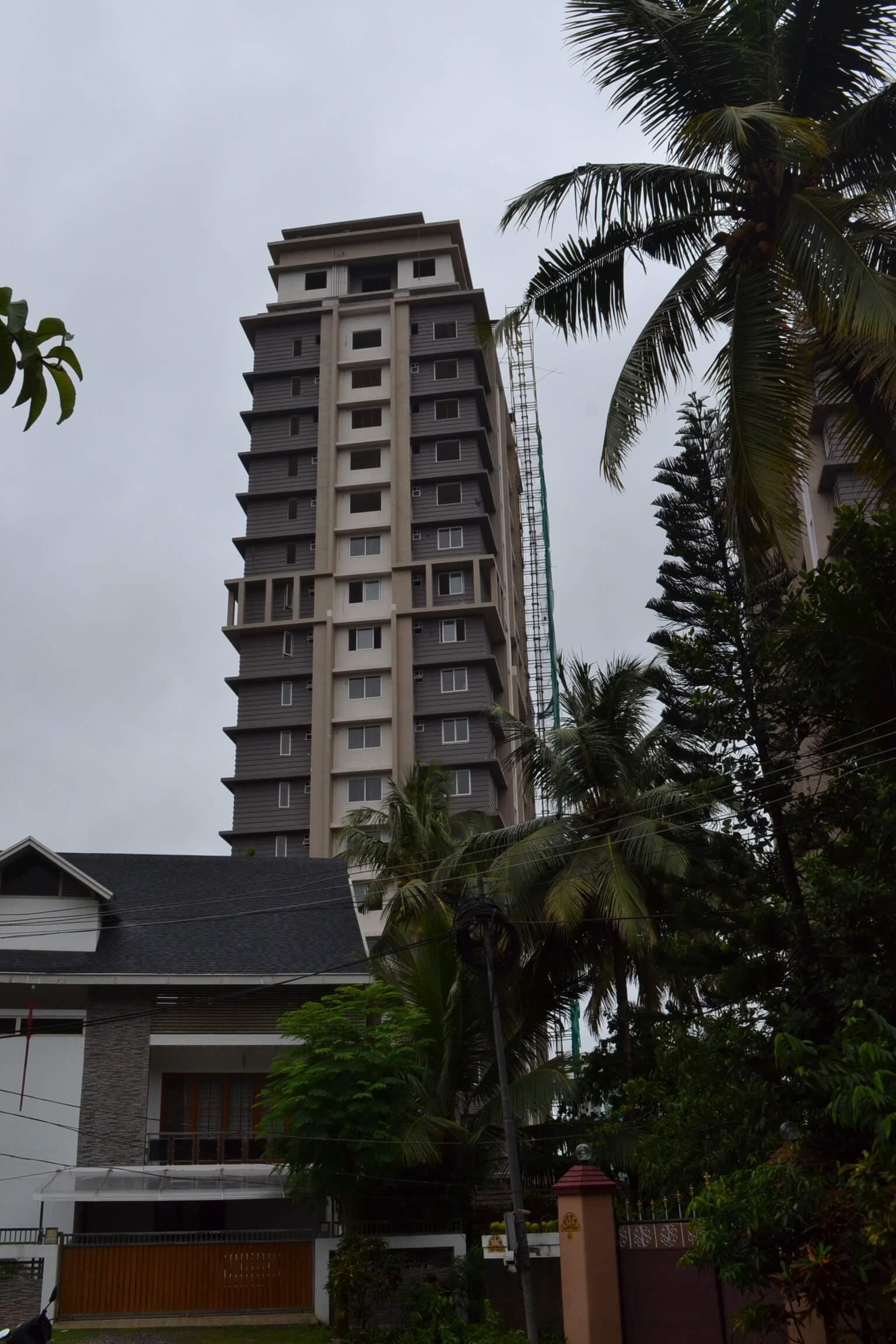

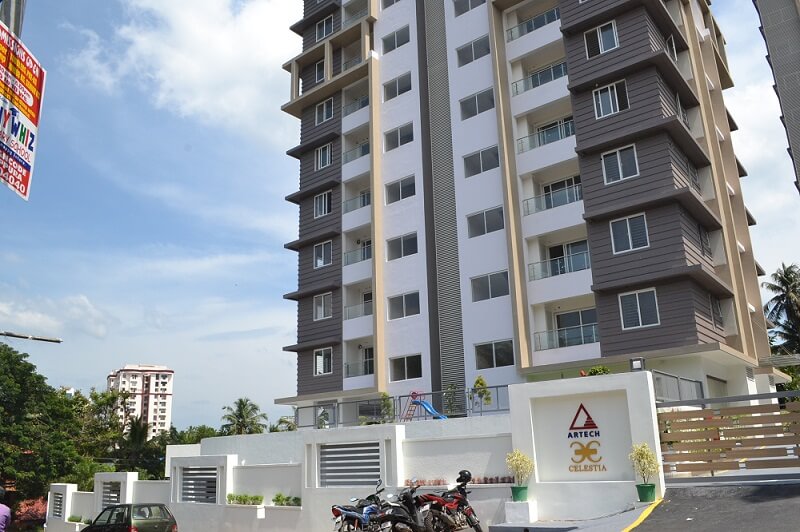

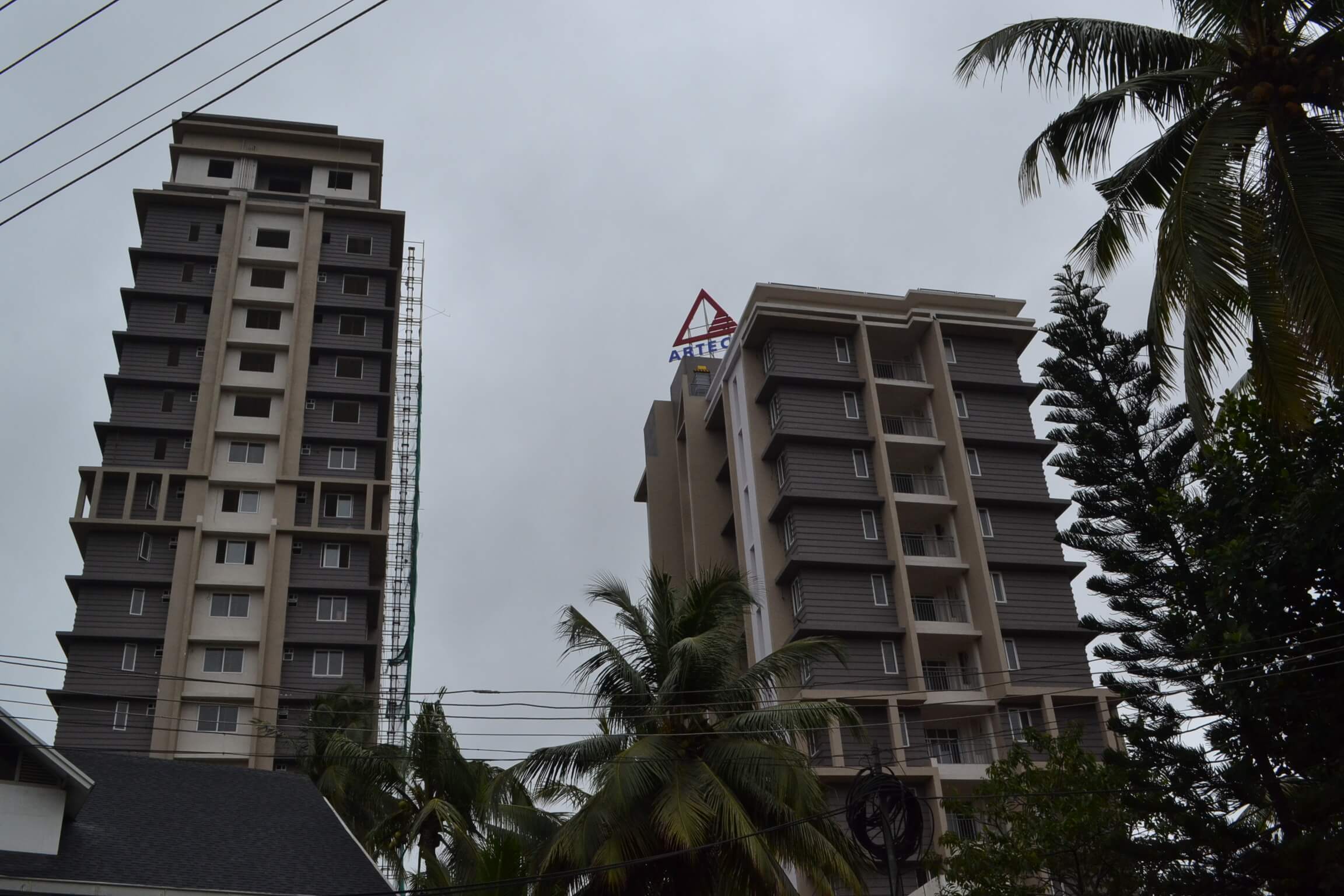

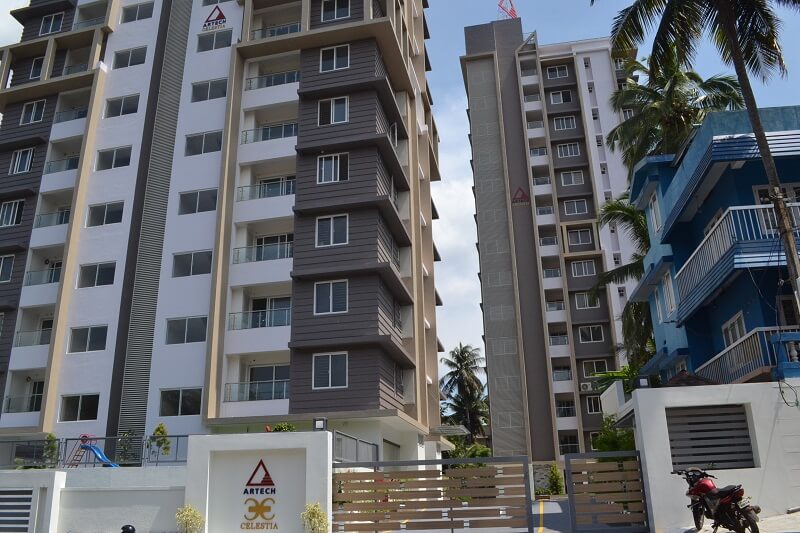

Artech Celestia - Progress
As per the current work status from our site we are targeted to complete the following works by end of July 2019
Tower 1
- Inside painting work – 100% to be completed
Work status as on 06.07.2019, we have completed the following
Tower 1
- RCC for Structure – 100% completed
- Ceiling plastering work -100% completed
- Block Masonry – 100% completed
- Wall plastering work – 100% completed
- External plastering work – 100% completed
- Inside 1st coat putty – 100% completed
- Inside 2nd coat putty – 100% completed

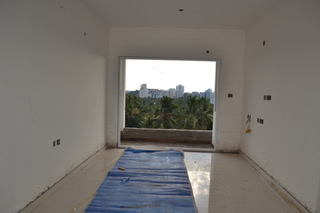

- Inside painting work -95% completed
- Outside painting work (1st coat) – 100% completed
- Tiling work – 100% to be completed
- Electrical HT work – 100% completed
- Electrical LT work – 100% completed
- Plumbing work- 100% completed
- Reticulated gas work-100%completed
- Fire Work-100%completed
- Yard work – 100% completed
Tower 2
- RCC for Structure – 100% completed
- Ceiling Plastering work – 1st to 13th floor – 100% completed
- Block/Brick masonry – 1st to 13th floor – 100% completed
- Wall plastering work – 100% completed
- Wire pulling work – 100% completed
- External plastering work – 100% completed
- Inside painting work – 100% completed
- Outside painting work (2nd coat) – 100% completed
- Plumbing work – 100% completed
- Electrical HT work – 100% completed
- Tiling work- 100% completed
- Aluminium Windows and Ventilators – 100% completed
- Yard work – 100% completed
As per the current work status from our site we are targeted to complete the following works by end of June 2019
Tower 1
- Inside painting work – 90% to be completed
Work status as on 06.06.2019, we have completed the following
Tower 1
- RCC for Structure – 100% completed
- Ceiling plastering work -100% completed
- Block Masonry – 100% completed
- Wall plastering work – 100% completed
- External plastering work – 100% completed
- Inside 1st coat putty – 100% completed
- Inside 2nd coat putty – 100% completed
- Inside painting work -85% completed
- Outside painting work (1st coat) – 100% completed
- Tiling work – 100% to be completed
- Electrical HT work – 100% completed
- Electrical LT work – 100% completed
- Plumbing work- 100% completed
- Reticulated gas work-100%completed
- Fire Work-100%completed
- Yard work – 100% completed
Tower 2
- RCC for Structure – 100% completed
- Ceiling Plastering work – 1st to 13th floor – 100% completed
- Block/Brick masonry – 1st to 13th floor – 100% completed
- Wall plastering work – 100% completed
- Wire pulling work – 100% completed
- External plastering work – 100% completed
- Inside painting work – 100% completed
- Outside painting work (2nd coat) – 100% completed
- Plumbing work – 100% completed
- Electrical HT work – 100% completed
- Tiling work- 100% completed
- Aluminium Windows and Ventilators – 100% completed
- Yard work – 100% completed
As per the current work status from our site we are targeted to complete the following works by end of May 2019
Tower 1
- Inside painting work – 90% to be completed
Work status as on 06.05.2019, we have completed the following
Tower 1
- RCC for Structure – 100% completed
- Ceiling plastering work -100% completed
- Block Masonry – 100% completed
- Wall plastering work – 100% completed
- External plastering work – 100% completed
- Inside 1st coat putty – 100% completed
- Inside 2nd coat putty – 100% completed
- Inside painting work -85% completed
- Outside painting work (1st coat) – 100% completed
- Tiling work – 100% to be completed
- Electrical HT work – 100% completed
- Electrical LT work – 100% completed
- Plumbing work- 100% completed
- Reticulated gas work-100%completed
- Fire Work-100%completed
- Yard work – 100% completed
Tower 2
- RCC for Structure – 100% completed
- Ceiling Plastering work – 1st to 13th floor – 100% completed
- Block/Brick masonry – 1st to 13th floor – 100% completed
- Wall plastering work – 100% completed
- Wire pulling work – 100% completed
- External plastering work – 100% completed
- Inside painting work – 100% completed
- Outside painting work (2nd coat) – 100% completed
- Plumbing work – 100% completed
- Electrical HT work – 100% completed
- Tiling work- 100% completed
- Aluminium Windows and Ventilators – 100% completed
- Yard work – 100% completed
As per the current work status from our site we are targeted to complete the following works by end of April 2019
Tower 1
- Inside painting work – 90% to be completed
Work status as on 05.04.2019, we have completed the following
Tower 1
- RCC for Structure – 100% completed
- Ceiling plastering work -100% completed
- Block Masonry – 100% completed
- Wall plastering work – 100% completed
- External plastering work – 100% completed
- Inside 1st coat putty – 100% completed
- Inside 2nd coat putty – 100% completed
- Inside painting work -80% completed
- Outside painting work (1st coat) – 100% completed
- Tiling work – 100% to be completed
- Electrical HT work – 100% completed
- Electrical LT work – 100% completed
- Plumbing work- 100% completed
- Reticulated gas work-100%completed
- Fire Work-100%completed
- Yard work – 100% completed
Tower 2
- RCC for Structure – 100% completed
- Ceiling Plastering work – 1st to 13th floor – 100% completed
- Block/Brick masonry – 1st to 13th floor – 100% completed
- Wall plastering work – 100% completed
- Wire pulling work – 100% completed
- External plastering work – 100% completed
- Inside painting work – 100% completed
- Outside painting work (2nd coat) – 100% completed
- Plumbing work – 100% completed
- Electrical HT work – 100% completed
- Tiling work- 100% completed
- Aluminium Windows and Ventilators – 100% completed
- Yard work – 100% completed
As per the current work status from our site we are targeted to complete the following works by end of March 2019
Tower 1
- Inside painting work – 80% to be completed
Work status as on 06-03-2019, we have completed the following
Tower 1
- RCC for Structure – 100% completed
- Ceiling plastering work -100% completed
- Block Masonry – 100% completed
- Wall plastering work – 100% completed
- External plastering work – 100% completed
- Inside 1st coat putty – 100% completed
- Inside 2nd coat putty – 100% completed
- Inside painting work -70% completed
- Outside painting work (1st coat) – 100% completed
- Tiling work – 100% to be completed
- Electrical HT work – 100% completed
- Electrical LT work – 100% completed
- Plumbing work- 100% completed
- Reticulated gas work-100%completed
- Firework-100%completed
- Yard work – 100% completed
Tower 2
-
-
- RCC for Structure – 100% completed
- Ceiling Plastering work – 1st to 13th floor – 100% completed
- Block/Brick masonry – 1st to 13th floor – 100% completed
- Wall plastering work – 100% completed
- Wire pulling work – 100% completed
- External plastering work – 100% completed
- Inside painting work – 100% completed
- Outside painting work (2nd coat) – 100% completed
- Plumbing work – 100% completed
- Electrical HT work – 100% completed
- Tiling work- 100% completed
- Aluminium Windows and Ventilators – 100% completed
- Yard work – 100% completed
-
As per the current work status from our site we are targeted to complete the following works by end of February 2019
Tower 1
-
-
- Inside painting work – 70% to be completed
-
Work status as on 05-02-2019, we have completed the following
Tower 1
-
-
- RCC for Structure – 100% completed
- Ceiling plastering work -100% completed
- Block Masonry – 100% completed
- Wall plastering work – 100% completed
- External plastering work – 100% completed
- Inside 1st coat putty – 100% completed
- Inside 2nd coat putty – 100% completed
- Inside painting work -50% completed
- Outside painting work (1st coat) – 100% completed
- Tiling work – 100% to be completed
- Electrical HT work – 100% completed
- Electrical LT work – 100% completed
- Plumbing work- 100% completed
- Reticulated gas work-100%completed
- Fire Work-100%completed
- Yard work – 100% completed
-
Tower 2
-
-
- RCC for Structure – 100% completed
- Ceiling Plastering work – 1st to 13th floor – 100% completed
- Block/Brick masonry – 1st to 13th floor – 100% completed
- Wall plastering work – 100% completed
- Wire pulling work – 100% completed
- External plastering work – 100% completed
- Inside painting work – 100% completed
- Outside painting work (2nd coat) – 100% completed
- Plumbing work – 100% completed
- Electrical HT work – 100% completed
- Tiling work- 100% completed
- Aluminium Windows and Ventilators – 100% completed
- Yard work – 100% completed
-
As per the current work status from our site we are targeted to complete the following works by end of January 2019
Tower 1
-
-
- Inside painting work (2nd coat putty) -90% to be completed
- Inside painting work – 50% to be completed
- Tiling work – 100% to be completed
-
Work status as on 08-01-2019, we have completed the following
Tower 1
-
-
- RCC for Structure – 100% completed
- Ceiling plastering work -100% completed
- Block Masonry – 100% completed
- Wall plastering work – 100% completed
- External plastering work – 100% completed
- Inside 1st coat putty – 100% completed
- Inside 2nd coat putty – 80% completed
- Inside painting work – 40% completed
- Outside painting work (1st coat) – 100% completed
- Tiling work – 95% completed
- Electrical HT work – 100% completed
- Electrical LT work – 100% completed
- Plumbing work- 100% completed
- Reticulated gas work-100%completed
- Fire Work-100%completed
- Yard work – 100% completed
-
Tower 2
-
-
- RCC for Structure – 100% completed
- Ceiling Plastering work – 1st to 13th floor – 100% completed
- Block/Brick masonry – 1st to 13th floor – 100% completed
- Wall plastering work – 100% completed
- Wire pulling work – 100% completed
- External plastering work – 100% completed
- Inside painting work – 100% completed
- Outside painting work (2nd coat) – 100% completed
- Plumbing work – 100% completed
- Electrical HT work – 100% completed
- Tiling work- 100% completed
- Aluminium Windows and Ventilators – 100% completed
- Yard work – 100% completed
-
As per the current work status from our site we are targeted to complete the following works by end of December 2019
Tower 1
-
-
- Inside painting work (2nd coat putty) -95% to be completed
- Tiling work – 100% to be completed
-
Work status as on 06-12-2018, we have completed the following
Tower 1
-
-
- RCC for Structure – 100% completed
- Ceiling plastering work -100% completed
- Block Masonry – 100% completed
- Wall plastering work – 100% completed
- External plastering work – 100% completed
- Inside painting work (1st coat putty) – 100% completed
- Inside painting work (2nd coat putty) – 70% completed
- Outside painting work (1st coat) – 100% completed
- Tiling work – 95% completed
- Electrical HT work – 100% completed
- Electrical LT work – 100% completed
- Plumbing work- 100% completed
- Reticulated gas work-100%completed
- Fire Work-100%completed
- Yard work – 100% completed
-
Tower 2
-
-
- RCC for Structure – 100% completed
- Ceiling Plastering work – 1st to 13th floor – 100% completed
- Block/Brick masonry – 1st to 13th floor – 100% completed
- Wall plastering work – 100% completed
- Wire pulling work – 100% completed
- External plastering work – 100% completed
- Inside painting work – 100% completed
- Outside painting work (2nd coat) – 100% completed
- Plumbing work – 100% completed
- Electrical HT work – 100% completed
- Tiling work- 100% completed
- Aluminium Windows and Ventilators – 100% completed
- Yard work – 100% completed
-
As per the current work status from our site we are targeted to complete the following works by end of November 2018
-
-
- Inside painting work (2nd coat putty) – 100% to be completed
- Tiling work – 100% to be completed
-
Work status as on 16-11-2018, we have completed the following.
Tower 1
-
-
- RCC for Structure – 100% completed
- Ceiling plastering work -100% completed
- Block Masonry – 100% completed
- Wall plastering work – 100% completed
- External plastering work – 100% completed
- Inside painting work (1st coat putty) – 100% completed
- Inside painting work (2nd coat putty) – 60% completed
- Outside painting work (1st coat) – 100% completed
- Tiling work – 95% completed
- Electrical HT work – 100% completed
- Electrical LT work – 100% completed
- Plumbing work- 100% completed
- Yard work – 100% completed
-
Tower 2
-
-
- RCC for Structure – 100% completed
- Ceiling Plastering work – 1st to 13th floor – 100% completed
- Block/Brick masonry – 1st to 13th floor – 100% completed
- Wall plastering work – 100% completed
- Wire pulling work – 100% completed
- External plastering work – 100% completed
- Inside painting work – 100% completed
- Outside painting work (2nd coat) – 100% completed
- Plumbing work – 100% completed
- Electrical HT work – 100% completed
- Tiling work- 100% completed
- Aluminium Windows and Ventilators – 100% completed
- Yard work – 100% completed
-
Work status as on September 2018, we have completed the following.
Tower 1
-
-
- RCC for Structure – 100% completed
- Ceiling plastering work -100% completed
- Block Masonry – 100% completed
- Wall plastering work – 100% completed
- External plastering work – 100% completed
- Inside painting work (1st coat putty) – 100% completed
- Outside painting work (1st coat) – 100% completed
- Tiling work -1st floor (60% completed); 2nd to 16th floor (100% completed); 17th floor (90% completed); 18th & 19th (90%completed); 20th & 21st floor – 80% completed
- Electrical HT work – 95% completed
- Electrical LT work – 95% completed
- Plumbing work- 95% completed
- Yard work – 95% completed
-
Tower 2
-
-
- RCC for Structure – 100% completed
- Ceiling Plastering work – 1st to 13th floor – 100% completed
- Block/Brick masonry – 1st to 13th floor – 100% completed
- Wall plastering work – 100% completed
- Wire pulling work – 100% completed
- External plastering work – 100% completed
- Inside painting work – 100% completed
- Outside painting work ( 2nd coat) – 95% completed
- Plumbing work – 100% completed
- Electrical HT work – 100% completed
- Tiling work- 100% completed
- Aluminium Windows and Ventilators – 100% completed
- Yard work – 95% completed
-
As per the current work status from our site we are targeted to complete the following works by end of September 2018
Tower 1
-
-
- Tiling work – 100% to be completed
- Electrical HT work – 100% to be completed
- Electrical LT work – 100% to be completed
- Yard work – 100% to be completed
-
Tower 2
-
-
- Outside painting work -100% to be completed
- Yard work- 100% to be completed
-
As per the current work status from our site we are targeted to complete the following works by end of July 2018
Tower 1
-
-
- Tiling work – 100% to be completed
- Electrical HT work – 100% to be completed
- Electrical LT work – 20th floor – 100% to be completed
- Plumbing work – 100% to be completed
- Yard work – 100% to be completed
-
Tower 2
-
-
- Inside painting work -100% to be completed
- Outside painting work -100% to be completed
- Electrical HT work – 100% to be completed
- Yard work- 100% to be completed
-
Work status as on 05-07-2018, we have completed the following.
Tower 1
-
-
- RCC for Structure – 100% completed
- Ceiling plastering work -100% completed
- Block Masonry – 100% completed
- Wall plastering work – 100% completed
- External plastering work – 100% completed
- Inside painting work (1st coat putty) – 100% completed
- Outside painting work (1st coat) – 100% completed
- Tiling work -2nd to 16th floor (100% completed); 18th floor (completed)
- Electrical LT work -1st to 19th floor (Wire pulling -100% completed)
- Plumbing work- 1st to 21st floor (consealed line) – (100% completed), duct line completed
- Yard work – 90% completed
-
Tower 2
-
-
- RCC for Structure – 100% completed
- Ceiling Plastering work – 1st to 13th floor – 100% completed
- Wall plastering work – 100% completed
- Wire pulling work – 100% completed
- External plastering work – 100% completed
- Inside painting work – 100% completed
- Outside painting work ( 2nd coat) – 95% completed
- Plumbing work – 100% completed
- Electrical HT work – 95% completed
- Tiling work- 100% completed
- Aluminium Windows and Ventilators – 100% completed
- Yard work – 95% completed
-
Work status as on 05-06-2018, we have completed the following.
Tower 1
-
-
- RCC for Structure – 100% completed
- Ceiling plastering work -100% completed
- Block Masonry – 100% completed
- Wall plastering work – 100% completed
- External plastering work – 100% completed
- Inside painting work (1st coat putty) – 100% completed
- Outside painting work (1st coat) – 100% completed
- Tiling work -2nd to 16th floor (100% completed); 18th floor (completed)
- Electrical HT work – 85% completed
- Electrical LT work -1st to 19th floor (Wire pulling -100% completed)
- Plumbing work- 1st to 21st floor (consealed line) – (100% completed)
- duct line completed
- Yard work – 90% completed
-
Work status as on 05-06-2018, we have completed the following
Tower 2
-
-
- RCC for Structure – 100% completed
- Ceiling Plastering work – 1st to 13th floor – 100% completed
- Block/Brick masonry – 1st to 13th floor – 100% completed
- Wall plastering work – 100% completed
- Wire pulling work – 100% completed
- External plastering work – 100% completed
- Inside painting work – 100% completed
- Outside painting work ( 2nd coat) – 95% completed
- Plumbing work – 100% completed
- Electrical HT work – 95% completed
- Tiling work- 100% completed
- Aluminum Windows and Ventilators – 100% completed
- Yard work – 95% completed
-
Work Schedule for the Month of July 2018
Tower 1
-
-
- Tiling work – 100% to be completed.
- Electrical HT work – 100% to be completed
- Electrical LT work – 20th floor – 100% to be completed
- Plumbing work – 100% to be completed
- Yard work – 100% to be completed
-
Work Schedule for the Month of July 2018
Tower 2
-
-
- Inside painting work -100% to be completed
- Outside painting work -100% to be completed
- Electrical HT work – 100% to be completed
- Yard work- 100% to be completed
-
As per the current work status from our site we are targeted to complete the following works by end of May 2018
Tower 1
-
-
- Block Masonry – GF – 100% to be completed
- Wall plastering work – 20th floor – 100% to be completed
- Inside painting work (1st coat putty) -100% to be completed
- Outside painting work (1st coat) – 100% to be completed
- Tiling work- 100% to be completed
- Electrical HT work – 100% to be completed
- Electrical LT work -100% to be completed
- Plumbing work – 100% to be completed
- Yard work -100% to be completed
-
Tower 2
-
-
- Inside painting work -100% to be completed
- Outside painting work -100% to be completed
- Electrical HT work – 100% to be completed
- Yard work- 100% to be completed
-
Work status as on 05-05-2018, we have completed the following.
Tower 1
-
-
- RCC for Structure – B2(100% completed); B1(100% completed); GF to 21st floor (100% completed); Terrace floor (100% completed)
- Ceiling plastering work -100% completed
- Block Masonry – B2,B1,1st to 20th floor(100% completed); GF(95% comlpleted);
- Wall plastering work – B2, B1 (95% completed); GF to 19th floor (100% completed);21st floor (100% completed);20th floor (95% completed)
- External plastering work – 1st to 19th floor(100% completed); 20th & 21st floor (100% completed)
- Inside painting work (1st coat putty)- 90% completed
- Outside painting work (1st coat) – 95% completed
- Tiling work-2nd to 16th floor (95% completed);18th floor (95% completed); 19th floor (20% completed); 17th floor (hold- tile not supplied by client)
- Electrical HT work – 70% completed
- Electrical LT work -1st to 18th floor (Wire pulling -100% completed) ; 19th floor (50% completed)
- Plumbing work- 1st to 21st floor – consealed line – (100% completed); duct line completed
- Yard work -70% completed
-
Tower 2
-
-
- RCC for Structure – 100% completed
- Ceiling Plastering work – 1st to 13th floor – 100% completed
- Block/Brick masonry – 1st to 13th floor – 100% completed
- Wall plastering work – 100% completed
- Wire pulling work – 100% completed
- External plastering work – 100% completed
- Inside painting work -90% completed
- Outside painting work -70% completed
- Plumbing work – 100% completed
- Electrical HT work – 90% completed
- Tiling work- 100% completed
- Aluminium Windows and Ventilators – 100% completed
- Yard work- 90% completed
-
As per the current work status from our site we are targeted to complete the following works by end of April 2018
Tower 1
-
-
- Block Masonry – GF – 100% to be completed
- Wall plastering work – 100% to be completed
- External plastering work – 100% to be completed
- Inside painting work (1st coat putty) -100% to be completed
- Outside painting work (1st coat) – 100% to be completed
- Tiling work- 100% to be completed
- Electrical HT work – 100% to be completed
- Electrical LT work -100 % to be completed
- Plumbing work – 100% to be completed
- Aluminium Windows and Ventilators – 100% to be completed
- Yard work -100% to be completed
-
Tower 2
-
-
- Inside painting work -100% to be completed
- Outside painting work -100% to be completed
- Electrical HT work – 100% to be completed
- Yard work- 100% to be completed
-
Work status as on 16-04-2018, we have completed the following.
Tower 1
-
-
- Wall plastering work – B2, B1 (90% completed); GF to 19th floor (100% completed);21st floor (100% completed);20th floor (90% completed)
- External plastering work – 1st to 19th floor(100% completed);20th & 21st floor (90% completed)
- Inside painting work (1st coat putty)- 80% completed
- Outside painting work (1st coat) – 40% completed
- Tiling work-2nd to 13th floor (95% completed);14th & 15th floor (80% completed)
- Electrical HT work -70% completed
- Electrical LT work -1st to 16th floor(Wire pliling-100% completed) ;17th & 18th floor (90% completed)
- Plumbing work- 1st to 16th floor (100% completed);17th floor (50% completed);18th & 19th floor(90% completed);20th & 21st floor (60% completed)
- Aluminium Windows and Ventilators – 2nd to 6th floor(80% completed);12th floor (50% completed); 13th floor (80% completed)
- Yard work -70% completed
-
Tower 2
-
-
- Inside painting work -80% completed
- Outside painting work -70% completed
- Plumbing work – 100% completed
- Electrical HT work – 80% completed
- Tiling work- 100% completed
- Aluminium Windows and Ventilators – 100% completed
- Yard work- 90% completed
-
As per the current work status from our site we are targeted to complete the following works by end of March 2018
Tower 1
-
-
- RCC for Structure -100% to be completed
- Block Masonry – GF – 100% to be completed
- Wall plastering work – 100% to be completed
- Inside painting work -100% to be completed
- External plastering work – 100% to be completed
- Outside painting work -100% to be completed
- Electrical HT work – 100% to be completed
- Electrical LT work -100 % to be completed
- Aluminium Windows and Ventilators – 100% to be completed
- Tiling work- 100% to be completed
- Plumbing work- 17th floor-100% to be completed
- Yard work -100% to be completed
-
Tower 2
-
-
- Yard work- 100% to be completed
- Electrical HT work – 100% to be completed
- Outside painting work -100% to be completed
- Inside painting work -100% to be completed
-
Work status as on 10-03-2018, we have completed the following.
Tower 1
-
-
- Aluminium Windows and Ventilators – 2nd to 6th floor(80% completed);12th floor A1 & 13th floor A1,A2(80% completed)
- Tiling work-2nd to 13th floor (95% completed);14th floor (60% completed)
- Plumbing work- 1st to 16th floor (100% completed);17th floor (50% completed);18th & 19th floor(90% completed);20th floor (20% completed)

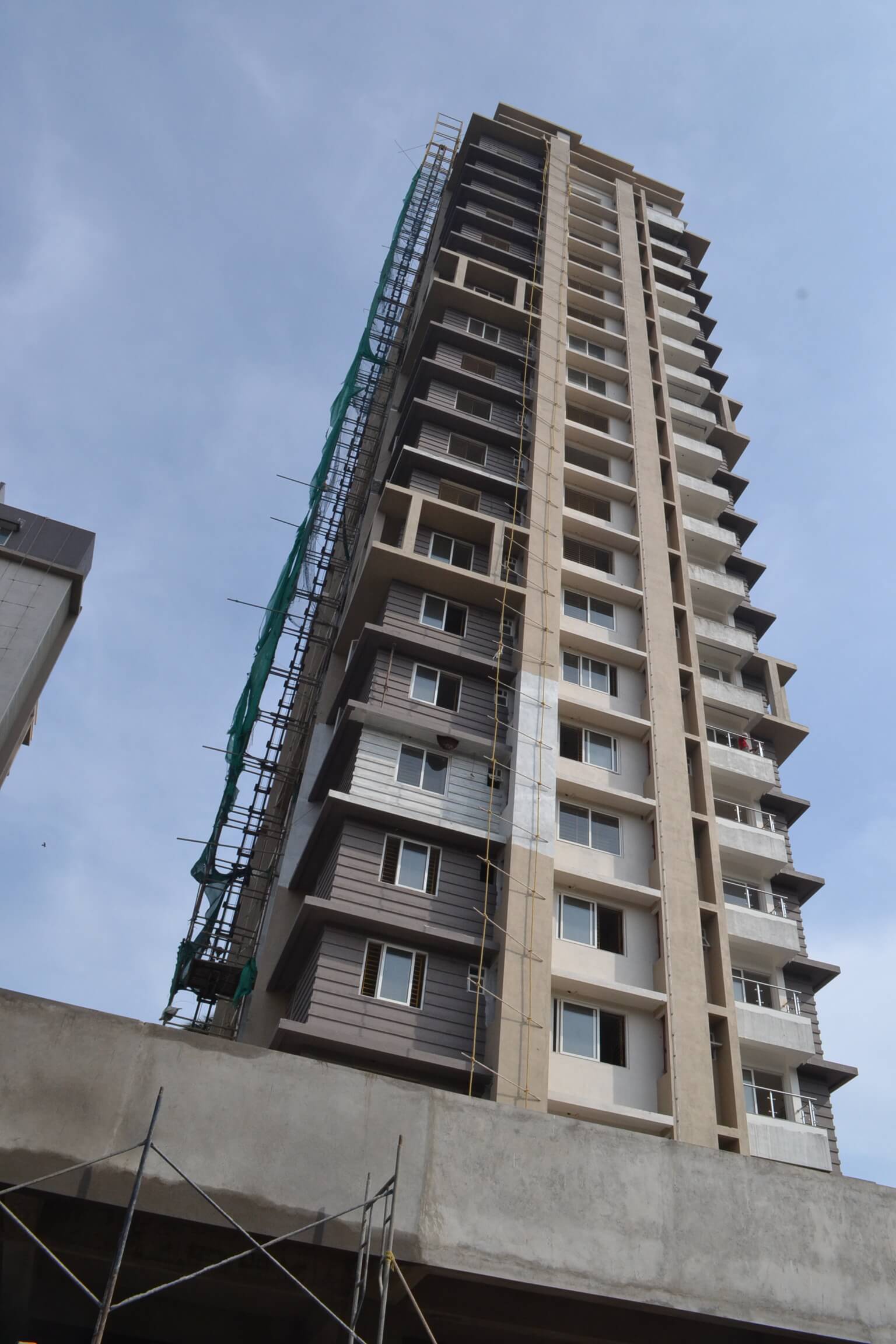

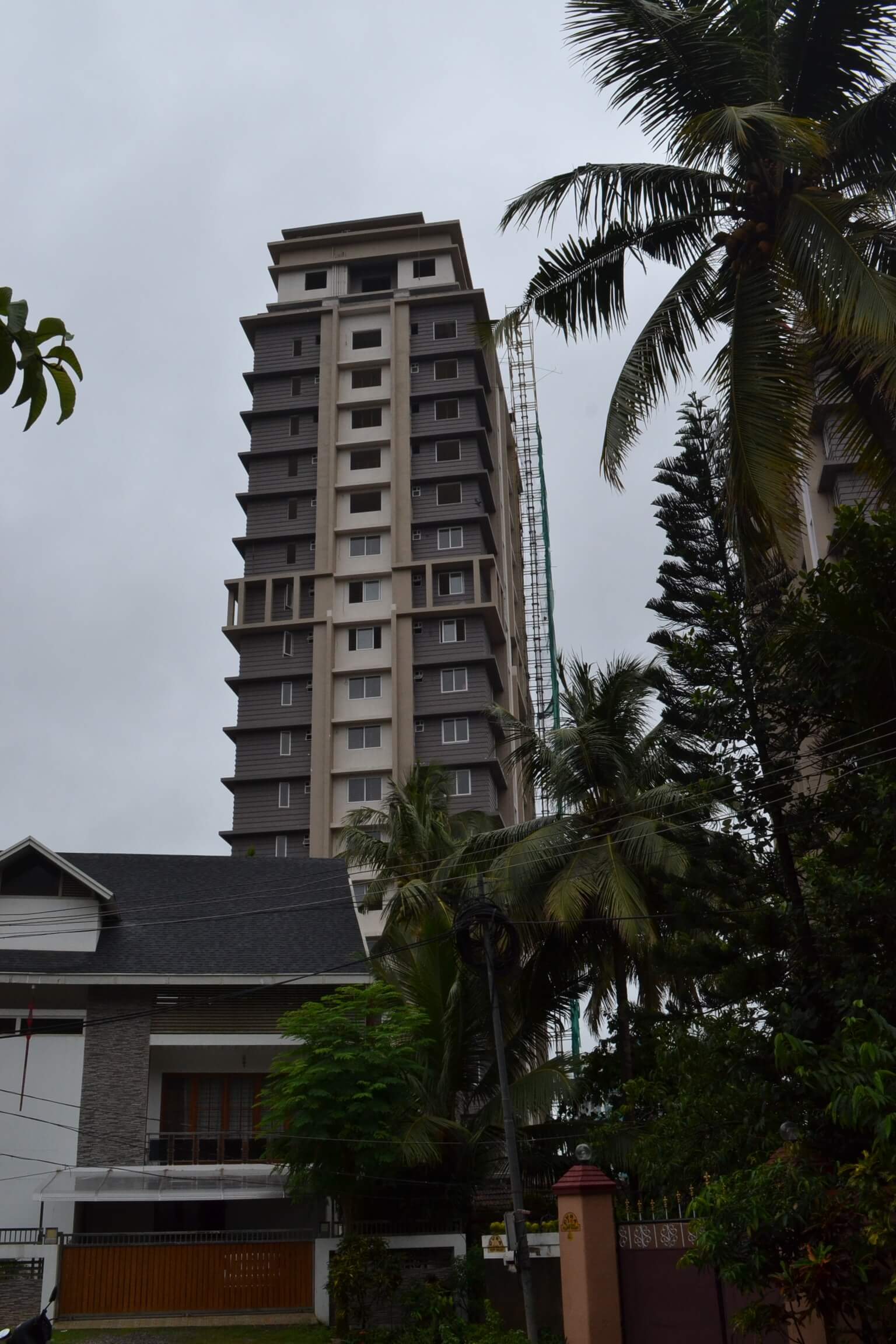

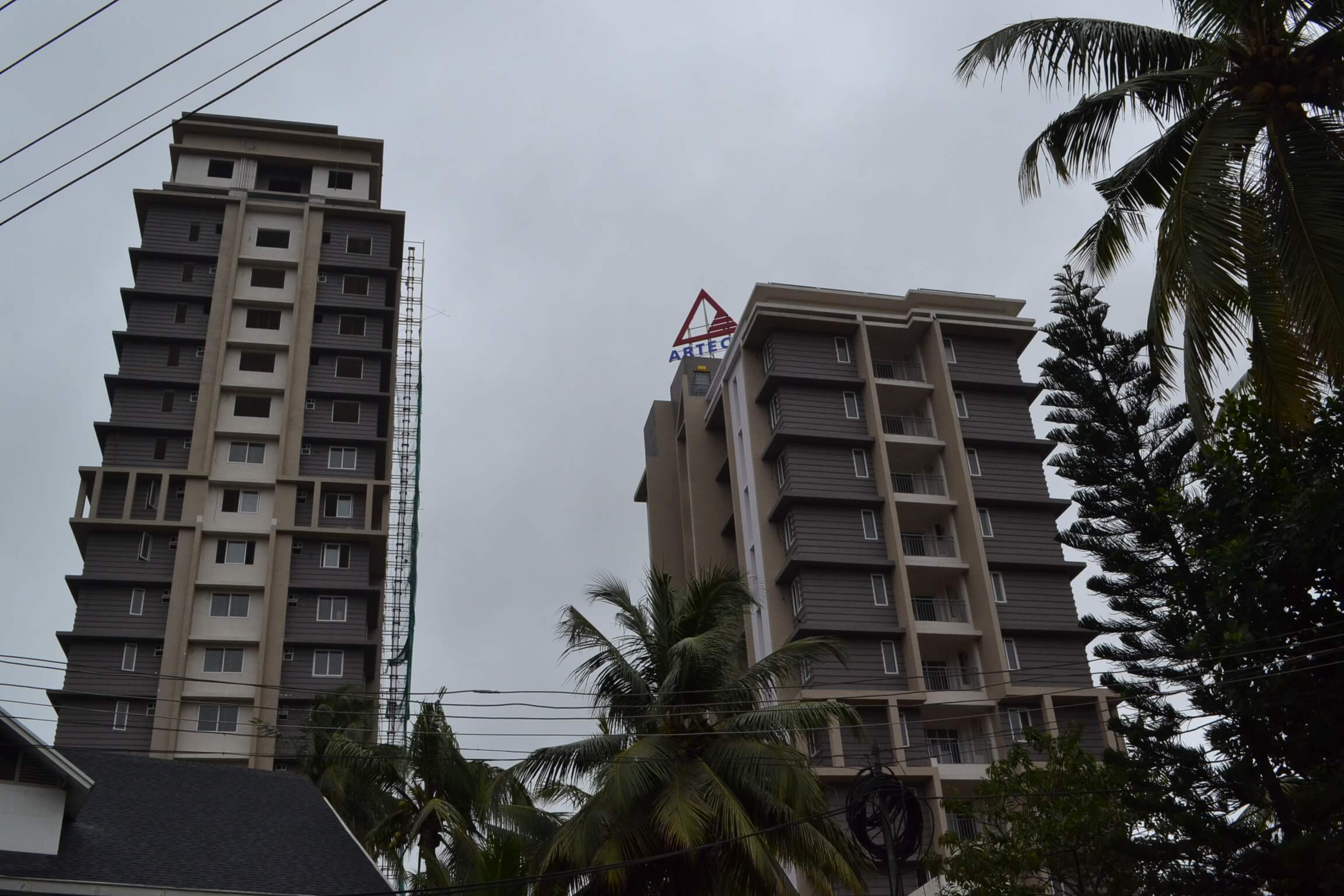

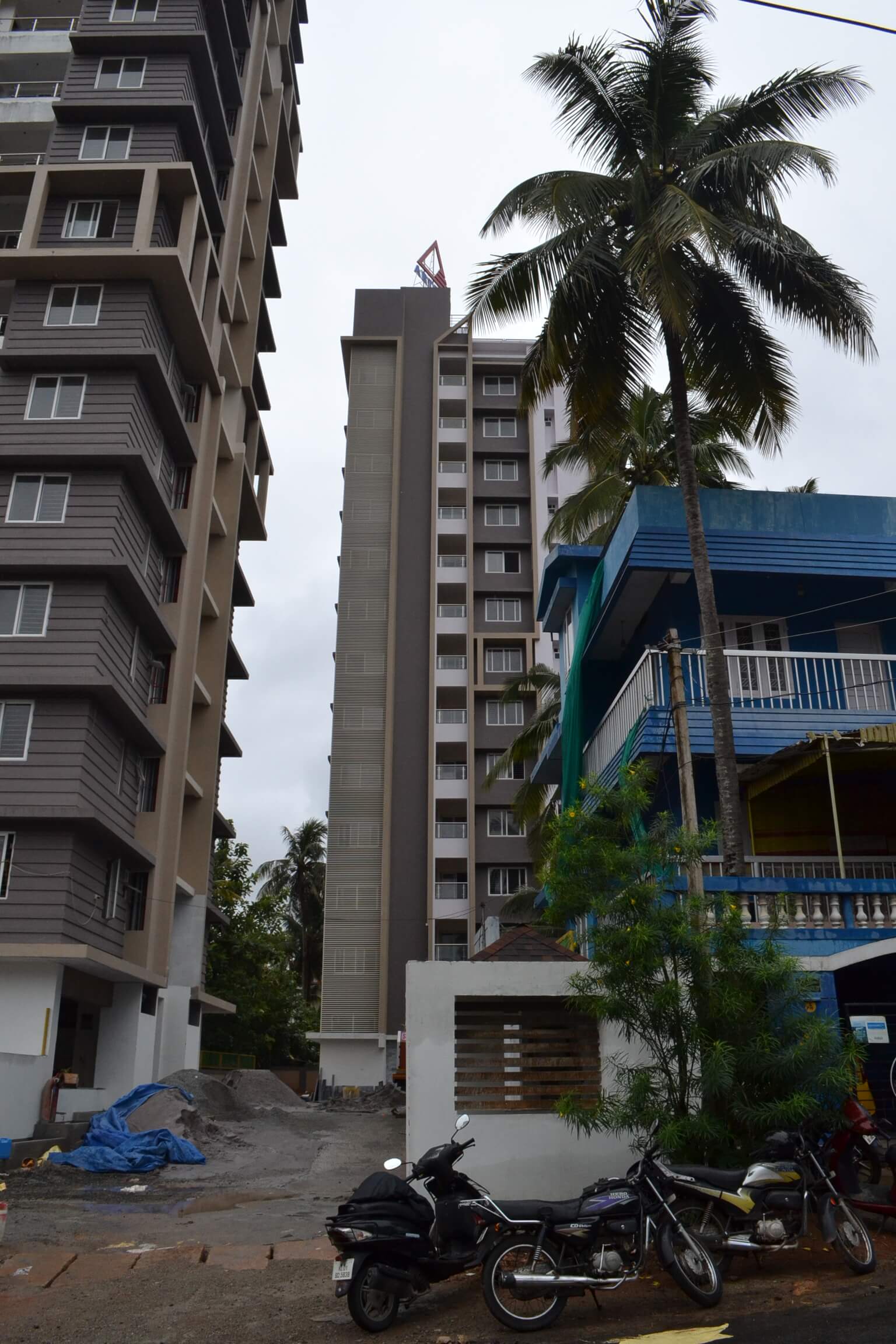

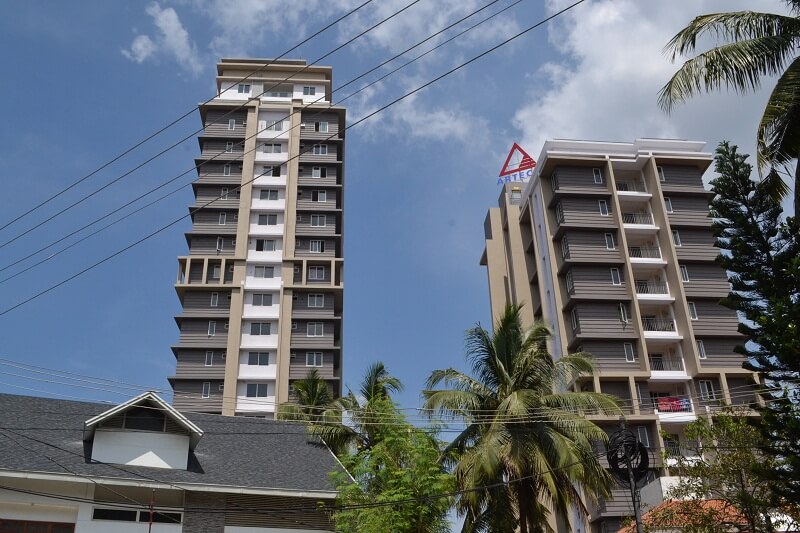

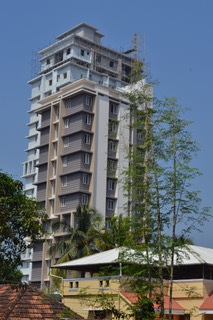

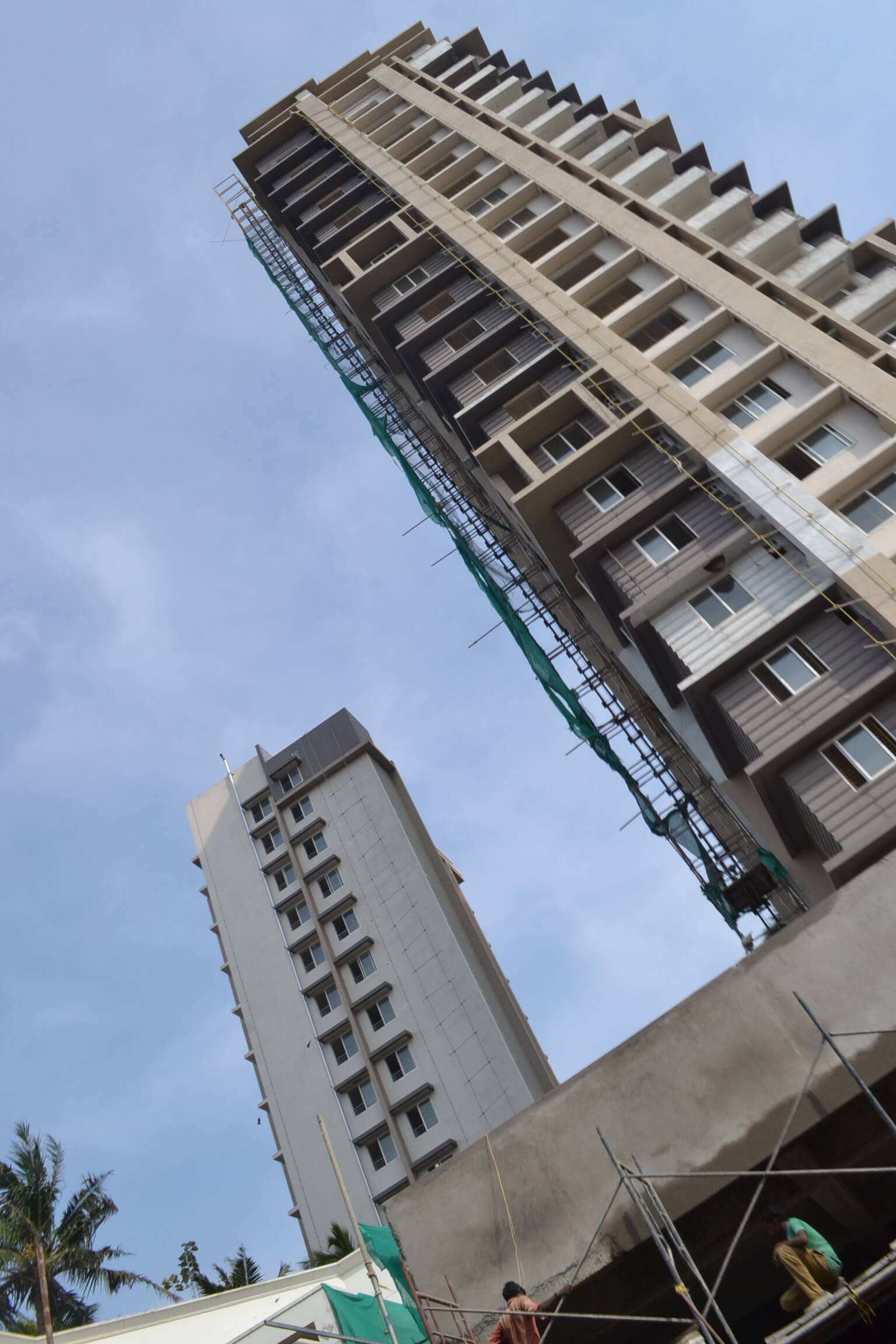

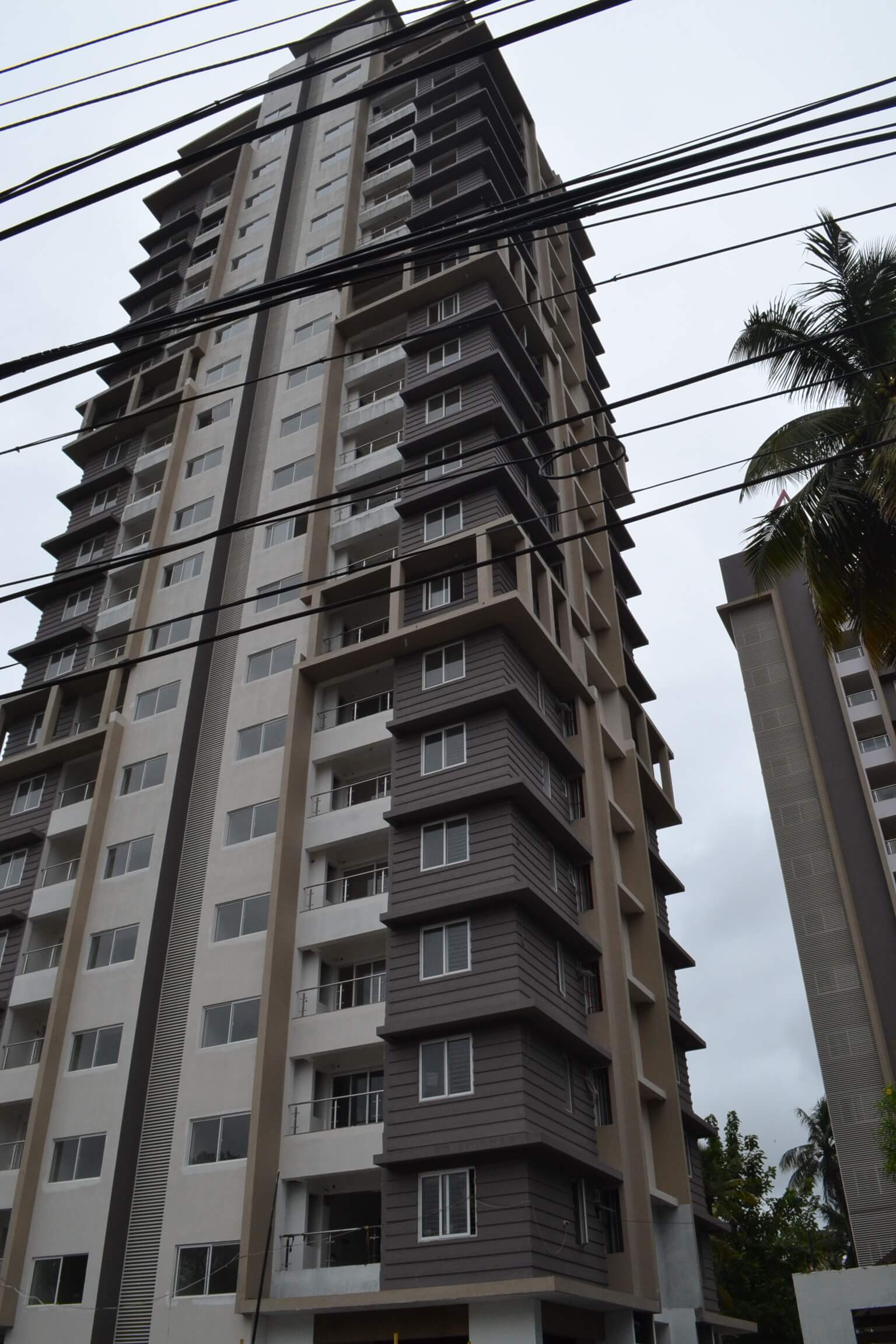

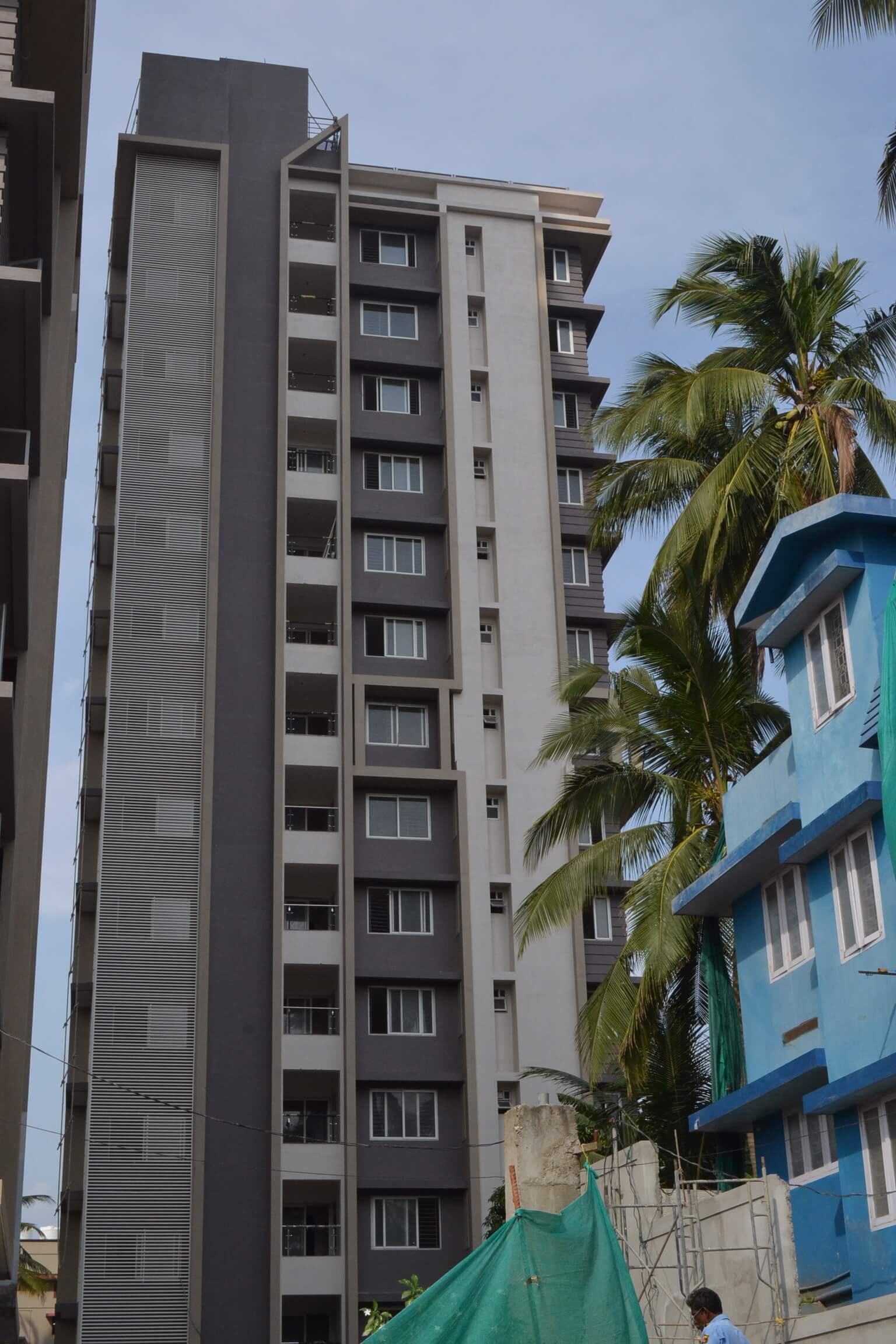

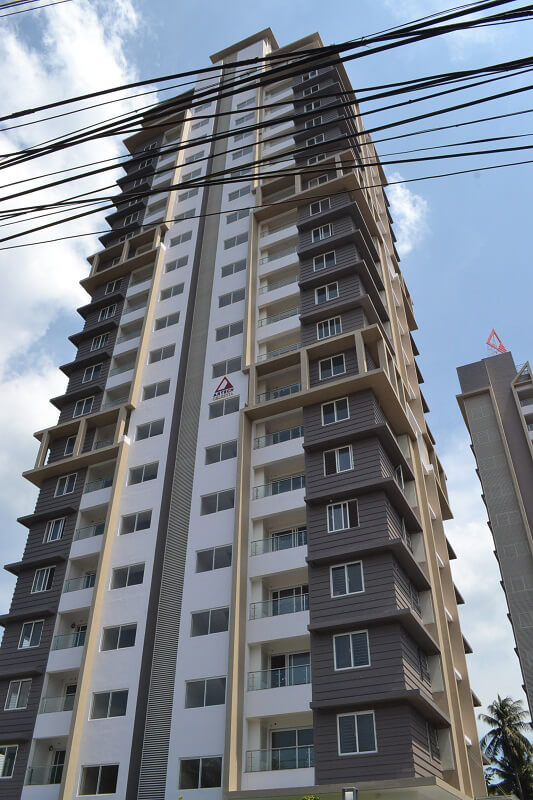

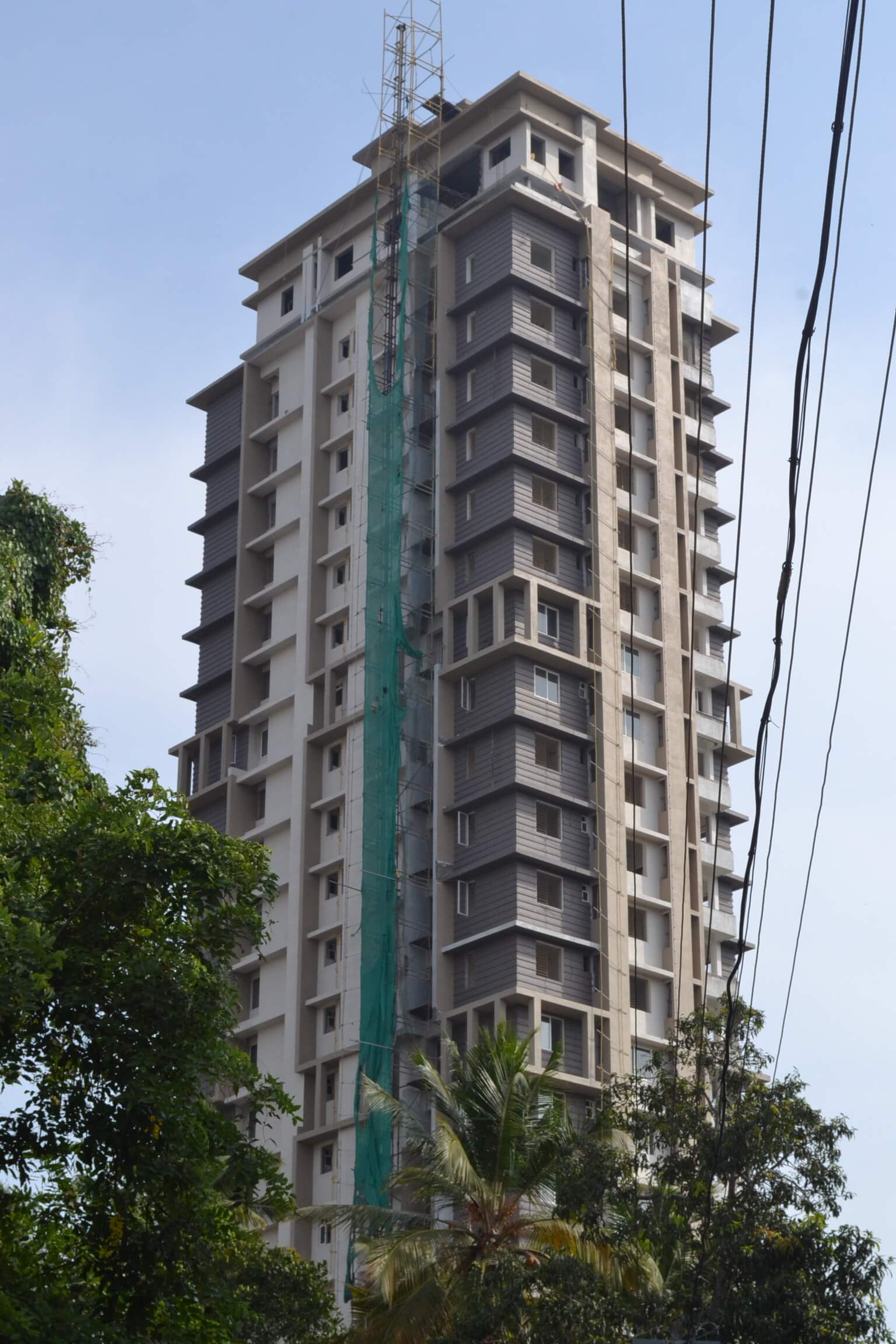

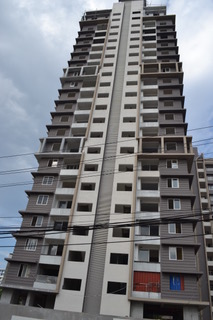

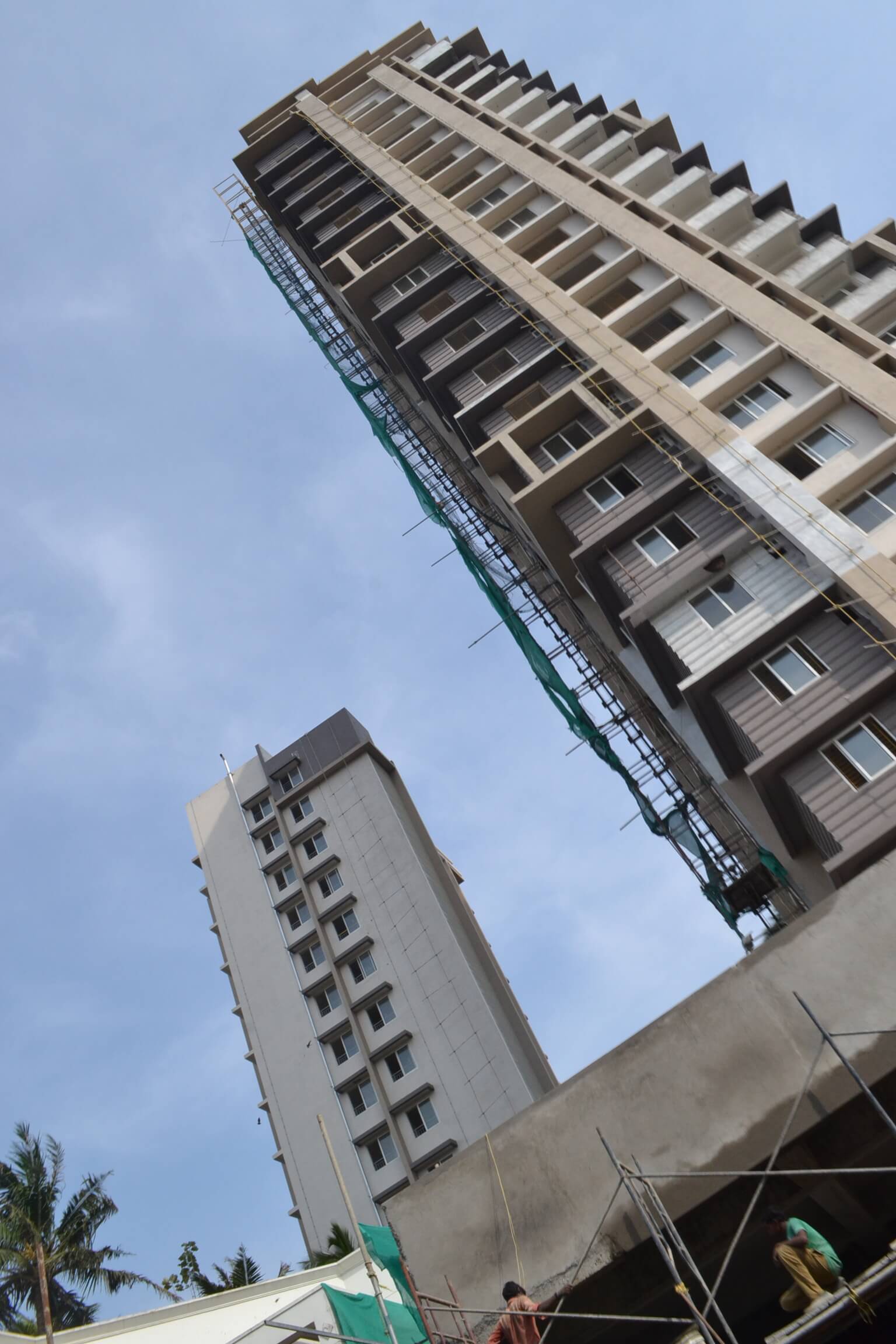

- Yard work -70% completed
-
Tower 2
-
-
- Inside painting work -80% completed
- External plastering work – 100% completed
- Outside painting work -70% completed
- Wire pulling work – 100% completed
- Electrical HT work – 80% completed
- Aluminium Windows and Ventilators – 100% completed
- Tiling work- 100% completed
- Plumbing work – 100% completed
- Yard work- 90% completed
-
As per the current work status from our site we are targeted to complete the following works by end of February-2018
Tower 1
-
-
- RCC for Structure -100% to be completed
- Block Masonry – GF – 100% to be completed
- Wall plastering work – 100% to be completed
- External plastering work – 100% to be completed
- Inside painting work -100% to be completed
- Outside painting work -100% to be completed
- Tiling work- 100% to be completed
- Electrical HT work – 100% to be completed
- Electrical LT work -100 % to be completed
- Plumbing work- 17th floor-100% to be completed
- Aluminium Windows and Ventilators – 100% to be completed
- Yard work -100% to be completed
-
Tower 2
-
-
- Inside painting work -100% to be completed
- Outside painting work -100% to be completed
- Electrical HT work – 100% to be completed
- Yard work- 100% to be completed
-
Work status as on 10- 02-2018, we have completed the following.
Tower 1
-
-
- Wall plastering work – B2, B1 (90% completed); GF to 19th(100% completed);21st floor (100% completed);20th floor (60% completed)
- External plastering work – 1st to 9th floor(100% completed);10th to 19th floor(95% completed),20th & 21st floor (80% completed)
- Inside painting work (1st coat putty)-70% completed
- Outside painting work (primer) -70% completed
- Tiling work-2nd to 13th floor (75% completed)
- Electrical HT work -60% completed
- Electrical LT work -1st to 16th floor(Wire pulling-100% completed) ;17th & 18th floor (60% completed)
- Plumbing work- 1st to 16th floor (100% completed);17th floor (50% completed)
- Aluminium Windows and Ventilators – 20% completed
- Yard work -70% completed
-
Tower 2
-
-
- Wire pulling work – 100% completed
- External plastering work – 100% completed
- Inside painting work -80% completed
- Outside painting work -70% completed
- Plumbing work – 100% completed
- Electrical HT work – 80% completed
- Tiling work- 100% completed
- Aluminium Windows and Ventilators – 100% completed
- Yard work- 90% completed
-
Work status as on 5-7-2017, we have completed
Tower 1
-
-
- RCC for Structure – completed
- Ceiling plastering work – progressing
- Block Masonry – progressing
- Wall plastering work – progressing
-
Tower 2
-
-
- RCC for Structure – completed
- Ceiling Plastering work – 1st to 13th floor – completed
- Block/Brick masonry – 1st to 13th floor – completed
- Wall plastering work – completed
- Wire pulling work – progressing
- External plastering work – progressing
-
Work status as on 9-5-2017, we have completed
Tower 1
-
-
- RCC for Structure -progressing
- Ceiling plastering work – progressing
- Block Masonry – progressing
- Wall plastering work – progressing
- External plastering work – 1st to 18th floor -progressing
-
Tower 2
-
-
- RCC for Structure – completed
- Ceiling Plastering work – 1st to 13th floor – completed
- Block/Brick masonry – 1st to 13th floor – completed
- Wall plastering work – completed
- Flooring work – 2nd to 11th floor -progressing
- Wire pulling work – 1st floor -progressing
-
Work status as on 7-3-2017, we have completed:
Tower 1
-
-
- RCC for Structure – progressing
- Ceiling plastering work – progressing
- External plastering work – progressing
-
Tower 2
-
-
- RCC for Structure – 100% completed
- Ceiling Plastering work – progressing
- Block/Brick masonry – progressing
- Wall plastering work – 100% completed
-
Work status as on 8-2-2017, we have completed:
Tower 1
-
-
- RCC for Structure – B2(80% completed); B1(80% completed); 19th roof (100% completed)
- Ceiling plastering work – B2(75%completed); 11th to 17th floor (90% completed); 18th floor (100% completed)
- Block Masonry – 13th to 16th floor (90% completed); 17th floor (90% completed); 18th floor (90% completed)
- Wall plastering work – 1st to 17th floor – 90% completed
- External plastering work – 40% completed
-
Tower 2
-
-
- RCC for Structure – 100% completed
- Ceiling Plastering work – 1st to 13th floor – 100% completed
- Block/Brick masonry – 1st to 13th floor – 100% completed
- Wall plastering work – 100% completed
- External plastering work – 90% completed
-
As per the current work status from our site we are targeted to complete the following works by end of February, 2017.
Tower 1
-
-
- RCC for Structure – 20th roof – 100% to be completed
- Ceiling plastering work – 19th floor – 100% to be completed
- Block Masonry – 17th,18th & 19th floor – 100% to be completed
- Wall plastering work – 18th floor – 100% to be completed
-
Tower 2
-
-
- External plastering work – 100% to be completed
-
Work status as on 06-5-2016, we have completed:
Tower 1
-
-
- RCC for Structure – 8th floor – completed
-
Tower 2
-
-
- RCC for Structure – 100% completed
- RCC for Structure – 100% completed
-
Construction progress as on 13th May 2015:
Tower-1
-
-
- Pile Cap work is progressing
-
Tower 2
-
-
- Slab RCC – 8th floor – 95% completed
- Ceiling plastering work – 4th floor – completed
- Block work – 2nd, 3rd and 4th floor – progressing
-
The following works are expected to be completed by end of May 2015.
Tower 2
-
-
- Slab RCC – 9th floor – 100% to be completed
- Ceiling plastering work – 5th & 6th floor – to be completed
- Block work – 2nd, 3rd and 4th floor – 100% to be completed
-
Piling of Tower 2 and Piling set out of Tower 1 has been completed now.
